Overview of Validation Requirements
in
Pharmaceutical Industry
Kaushik Desai
Chairman,
Industrial Pharmacy Division
Indian Pharmaceutical Association
www.ipapharma.org
1

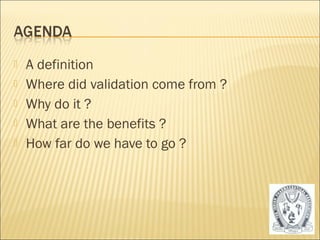

 A definition
 Where did validation come from ?
 Why do it ?
 What are the benefits ?
 How far do we have to go ?
2

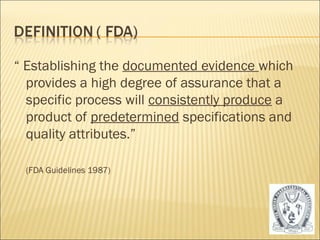

“ Establishing the documented evidence which
provides a high degree of assurance that a
specific process will consistently produce a
product of predetermined specifications and
quality attributes.”
(FDA Guidelines 1987)
3
“Process validation is defined as the collection
& evaluation of data, from the process design
stage through commercial production, which
establishes scientific evidence that process is
capable of consistently delivering quality
product.”
(FDA Guidelines, 2011)
4
“Action of proving, in accordance with the
principles of Good Manufacturing Practice
(GMP), that any procedure, process,
equipment, material, activity or system
actually leads to expected results.”
(EU GMP 1997)
5

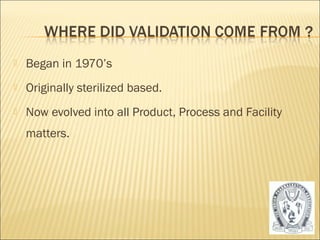

 Began in 1970’s
 Originally sterilized based.
 Now evolved into all Product, Process and Facility
matters.
6

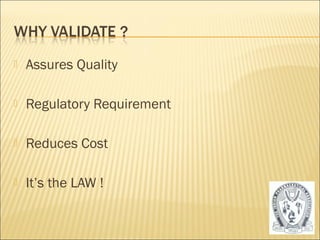

 Assures Quality
 Regulatory Requirement
 Reduces Cost
 It’s the LAW !
7

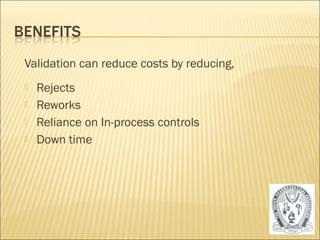

Validation can reduce costs by reducing,
 Rejects
 Reworks
 Reliance on In-process controls
 Down time
8
 Reliance on product testing
 Loss of confidence
 Possibility of adulterated products
 Inspection : Observations / 483’s
9
 User Requirement Specification (URS)
 Design Qualification
 Impact Assessment
 Factory Acceptance Testing
 Installation Qualification

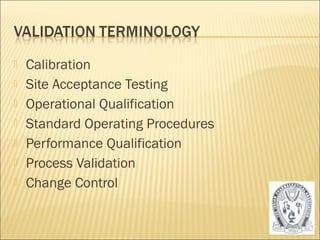

10
 Calibration
 Site Acceptance Testing
 Operational Qualification
 Standard Operating Procedures
 Performance Qualification
 Process Validation
 Change Control
11
User Requirement Specification (URS)
 A description of the requirements of the facility
(project) in terms of product to be manufactured,
required throughput and conditions in which the
product should be manufactured.
 Approved statements prepared by the user which
defines what is required by the project.
12

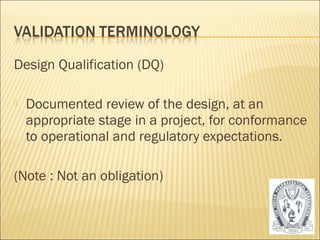

Design Qualification (DQ)
 Documented review of the design, at an
appropriate stage in a project, for conformance
to operational and regulatory expectations.
(Note : Not an obligation)
13
Impact Assessment
 The process of evaluating the impact of the
operating, controlling, alarming and failure
conditions of a system on the quality of a
product
14

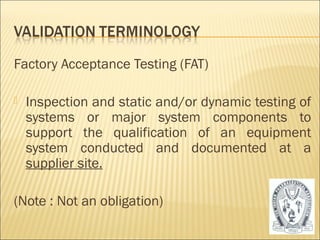

Factory Acceptance Testing (FAT)
 Inspection and static and/or dynamic testing of
systems or major system components to
support the qualification of an equipment
system conducted and documented at a
supplier site.
(Note : Not an obligation)
15

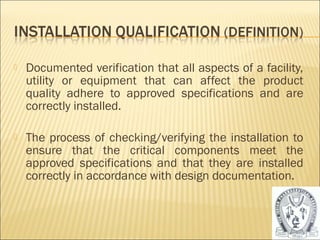

 Documented verification that all aspects of a facility,
utility or equipment that can affect the product
quality adhere to approved specifications and are
correctly installed.
 The process of checking/verifying the installation to
ensure that the critical components meet the
approved specifications and that they are installed
correctly in accordance with design documentation.
16

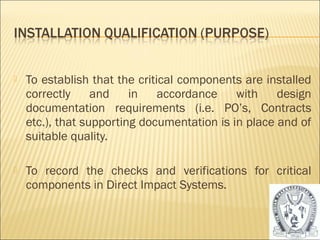

 To establish that the critical components are installed
correctly and in accordance with design
documentation requirements (i.e. PO’s, Contracts
etc.), that supporting documentation is in place and of
suitable quality.
 To record the checks and verifications for critical
components in Direct Impact Systems.

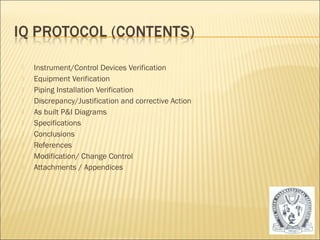

17
 Approval Page
 Objectives
 System Description
 Responsibilities
 Acceptance Criteria
 Engineering Documentation Requirements
 Records of Signatures
 Qualification Test Equipment/Instrument List
 Product Contact Materials Review
 Utilities Verification
 Control System Verification
18
 Instrument/Control Devices Verification
 Equipment Verification
 Piping Installation Verification
 Discrepancy/Justification and corrective Action
 As built P&I Diagrams
 Specifications
 Conclusions
 References
 Modification/ Change Control
 Attachments / Appendices
19

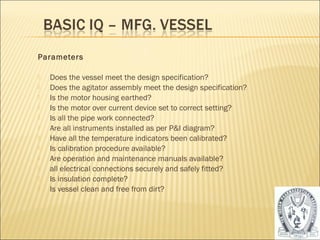

Parameters
 Does the vessel meet the design specification?
 Does the agitator assembly meet the design specification?
 Is the motor housing earthed?
 Is the motor over current device set to correct setting?
 Is all the pipe work connected?
 Are all instruments installed as per P&I diagram?
 Have all the temperature indicators been calibrated?
 Is calibration procedure available?
 Are operation and maintenance manuals available?
 all electrical connections securely and safely fitted?
 Is insulation complete?
 Is vessel clean and free from dirt?
20

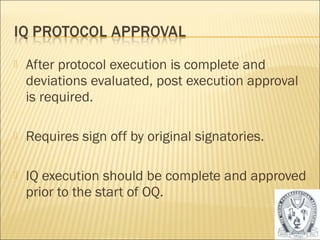

 After protocol execution is complete and
deviations evaluated, post execution approval
is required.
 Requires sign off by original signatories.
 IQ execution should be complete and approved
prior to the start of OQ.
21

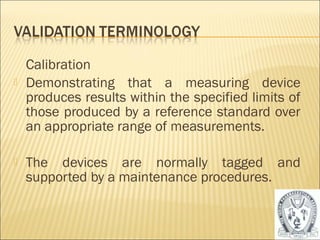

Calibration
 Demonstrating that a measuring device
produces results within the specified limits of
those produced by a reference standard over
an appropriate range of measurements.
 The devices are normally tagged and
supported by a maintenance procedures.
22
Site Acceptance Testing (SAT)
 Inspection and dynamic testing of systems or
major system components to support the
qualification of an equipment system
conducted at a client site.
(Note : Not an obligation)
23
 Documented verification that all aspects of
a facility, utility or equipment that can affect
product quality operate as intended
throughout all anticipated ranges. It is the
process of testing to ensure that individual
components and systems operate as
specified, and how that information is
recorded.
24

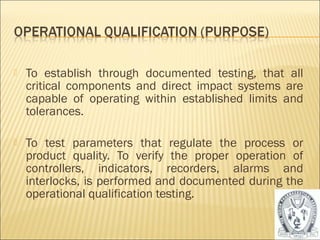

 To establish through documented testing, that all
critical components and direct impact systems are
capable of operating within established limits and
tolerances.
 To test parameters that regulate the process or
product quality. To verify the proper operation of
controllers, indicators, recorders, alarms and
interlocks, is performed and documented during the
operational qualification testing.
25

 Approval page
 Pre-requisites
 Objectives
 System Description
 Responsibilities
 Acceptance Criteria
 Records of signatures
 Qualification test Equipment/Instruments list
 Alarm and Interlocks test
 Operation testing
 Capacity testing
 Power failure testing
26

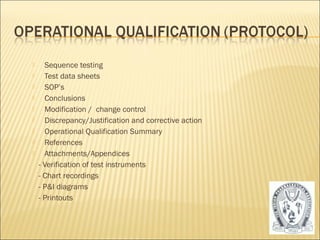

 Sequence testing
 Test data sheets
 SOP’s
 Conclusions
 Modification / change control
 Discrepancy/Justification and corrective action
 Operational Qualification Summary
 References
 Attachments/Appendices
- Verification of test instruments
- Chart recordings
- P&I diagrams
- Printouts
27

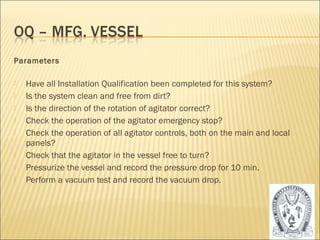

Parameters
 Have all Installation Qualification been completed for this system?
 Is the system clean and free from dirt?
 Is the direction of the rotation of agitator correct?
 Check the operation of the agitator emergency stop?
 Check the operation of all agitator controls, both on the main and local
panels?
 Check that the agitator in the vessel free to turn?
 Pressurize the vessel and record the pressure drop for 10 min.
 Perform a vacuum test and record the vacuum drop.
28
 Documented verification that all aspects of
a facility, utility or equipment that can
affect the product quality perform as
intended in meeting the predetermined
acceptance criteria.
29
 To integrate procedures, personnel, systems
and materials to verify that the utility /
environment / equipment / support systems
produces the required output. This output
may be a product contact utility, sterilization
condition or environment.
30
 Approval page
 Pre-requisites
 Objectives
 System Description
 Responsibilities
 Acceptance Criteria
 PQ test plan
 Challenge test plan
 Records of signatures
 Test equipment/Instrument list
 Test data sheets
 SOP’s
 References
 Conclusions
 Attachments
31
Process Validation
 The documented verification providing a high
degree of assurance that a specific process will
consistently produce a product meeting its
predetermined specifications and quality
attributes.
 The new guidelines aligns process validation
activities with a product life cycle concept.
32

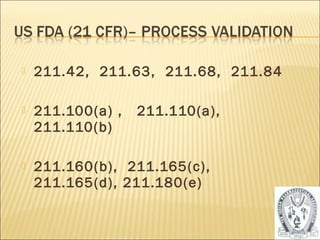

 211.42, 211.63, 211.68, 211.84
 211.100(a) , 211.110(a),
211.110(b)
 211.160(b), 211.165(c),
211.165(d), 211.180(e)
33
Life Cycle of the product & the process
 Stage 1 – Process Design
 Stage 2 – Process qualification
 Stage 3 - Continuous process verification
34

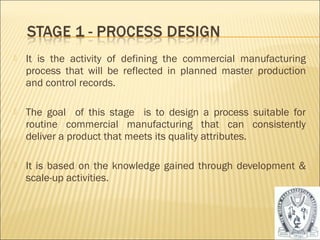

 It is the activity of defining the commercial manufacturing
process that will be reflected in planned master production
and control records.
 The goal of this stage is to design a process suitable for
routine commercial manufacturing that can consistently
deliver a product that meets its quality attributes.
 It is based on the knowledge gained through development &
scale-up activities.
35
During this stage, the process design is evaluated to
determine if the process is capable of reproducible
commercial manufacturing. The products
manufactured during this stage, if acceptable , can be
released for distribution.
Two Aspects
 Design of facility and qualification of equipment and
utilities.
 Process Performance Qualification ( PPQ).
36

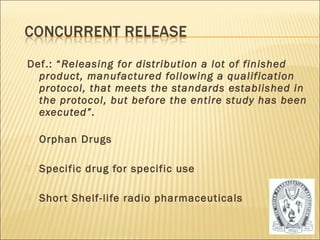

Def.: “Releasing for distribution a lot of finished
product, manufactured following a qualification
protocol, that meets the standards established in
the protocol, but before the entire study has been
executed”.
 Orphan Drugs
 Specific drug for specific use
 Shor t Shelf-life radio pharmaceuticals
37

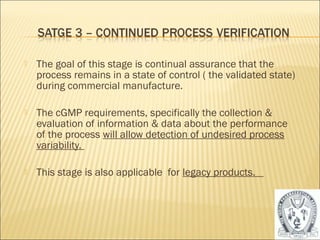

 The goal of this stage is continual assurance that the
process remains in a state of control ( the validated state)
during commercial manufacture.
 The cGMP requirements, specifically the collection &
evaluation of information & data about the performance
of the process will allow detection of undesired process
variability.
 This stage is also applicable for legacy products.
38
Change Control
 Formal evaluation of the potential impact of
planned modifications on the validated status
of a product, process or facility.
39
 Training personnel for IQ/OQ execution.
 The purpose of the equipment/ system.
 Use of test equipment
 Applicable SOP’s
 cGMP documentation of training
 Document all training
 Periodically review training requirements
40

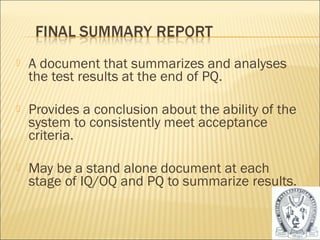

 A document that summarizes and analyses
the test results at the end of PQ.
 Provides a conclusion about the ability of the
system to consistently meet acceptance
criteria.
 May be a stand alone document at each
stage of IQ/OQ and PQ to summarize results.
41

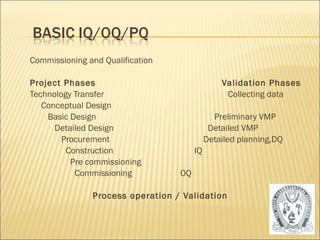

Commissioning and Qualification
Project Phases Validation Phases
Technology Transfer Collecting data
Conceptual Design
Basic Design Preliminary VMP
Detailed Design Detailed VMP
Procurement Detailed planning,DQ
Construction IQ
Pre commissioning
Commissioning OQ
Process operation / Validation
42
43
Introduction Qualification Personnel Schedule Preventive
Maintenance
Installation
Operation
Process
Responsibilities
Training
Change
Control
Procedures
Documents
Appendices
The company’s overall policy, intentions and
approach to validation, including :
 Validation of production processes
 Cleaning procedures
 Analytical methods
 In-process control test procedures
 Computerized systems
 Persons responsible for design, review, approval
 Documentation of each validation phase
44
 Product validation is NOT ……
- just 3 batches that meet specifications
 Product validation is ……
- an ongoing process to build confidence into
the manufacturing activities
- an ability to demonstrate consistency at any
time.
45
 Cleaning validation is establishing
documented evidence that the equipment
is consistently cleaned from product,
microbial and cleaning agent residues to
predetermined acceptable levels.
46
A written procedure for cleaning validation
which includes :
 Responsibility for development, performance and
approval of the validation study.
 Establishment of SOP’s
 Acceptance criteria
- defined to prevent cross contamination
- definition of residue limits
47
 Cleaning procedure for each piece of equipment
- Flow charts and diagrams
- Cleaning agents, concentration, volume
- Frequency
- time left ‘dirty’
48
 Sampling procedures
- swabs, rinse, location
 Residue limits
 Analytical methods
49
 Validation report
- Results Vs. acceptance criteria
- Deviations and how handled
- Conclusion that cleaning process is
validated
50
 Major change in cleaning procedure
 Change in cleaning agent
 New equipment
51
 Knowledge of the materials
- Potency of the drug
- Pharmacological and toxic properties
- Degradation products
- Cleaning agents
- Micro residues
52
Residual Limits must be………….
 Practical
 Achievable
 Verifiable
 Safe
FDA does not set acceptance specifications
(limits).
53
MAC = TD x BS x SF / LDD
MAC = Maximum Allowable Carryover
TD = Single Therapeutic Dose
BS = Batch size of next product to be
manufactured on the same equipment.
SF = Safety Factor
LDD = Largest Daily Dose of the next product
in the same equipment.
54
Ranitidine Tablets - Ibuprofen Tablets
TD = Single Therapeutic Dose = 150 mg Ranitidine-Tab
BS = Batch Size = 100 kg of Ibuprofen
SF = Safety Factor = 1/1000
LDD = Largest Daily Dose of the next product in the same
equipment = 200 mg X 5 tablets of Ibuprofen
MAC = Max Allowable Carryover = 150 X 100 X 1000 x
1000 X 1/1000 X 1/1000
i.e 15000 mg in 100 kg Batch size
i.e 150 mg in 1 kg = 150 ppm
55
Validation

Validation

  • 1.
    Overview of ValidationRequirements in Pharmaceutical Industry Kaushik Desai Chairman, Industrial Pharmacy Division Indian Pharmaceutical Association www.ipapharma.org 1
  • 2.
     A definition  Where did validation come from ?  Why do it ?  What are the benefits ?  How far do we have to go ? 2
  • 3.
    “ Establishing thedocumented evidence which provides a high degree of assurance that a specific process will consistently produce a product of predetermined specifications and quality attributes.” (FDA Guidelines 1987) 3
  • 4.
    “Process validation isdefined as the collection & evaluation of data, from the process design stage through commercial production, which establishes scientific evidence that process is capable of consistently delivering quality product.” (FDA Guidelines, 2011) 4
  • 5.
    “Action of proving,in accordance with the principles of Good Manufacturing Practice (GMP), that any procedure, process, equipment, material, activity or system actually leads to expected results.” (EU GMP 1997) 5
  • 6.
     Began in1970’s  Originally sterilized based.  Now evolved into all Product, Process and Facility matters. 6
  • 7.
     Assures Quality  Regulatory Requirement  Reduces Cost  It’s the LAW ! 7
  • 8.
    Validation can reducecosts by reducing,  Rejects  Reworks  Reliance on In-process controls  Down time 8
  • 9.
     Reliance onproduct testing  Loss of confidence  Possibility of adulterated products  Inspection : Observations / 483’s 9
  • 10.
     User RequirementSpecification (URS)  Design Qualification  Impact Assessment  Factory Acceptance Testing  Installation Qualification 10
  • 11.
     Calibration Site Acceptance Testing  Operational Qualification  Standard Operating Procedures  Performance Qualification  Process Validation  Change Control 11
  • 12.
    User Requirement Specification(URS)  A description of the requirements of the facility (project) in terms of product to be manufactured, required throughput and conditions in which the product should be manufactured.  Approved statements prepared by the user which defines what is required by the project. 12
  • 13.
    Design Qualification (DQ)  Documented review of the design, at an appropriate stage in a project, for conformance to operational and regulatory expectations. (Note : Not an obligation) 13
  • 14.
    Impact Assessment The process of evaluating the impact of the operating, controlling, alarming and failure conditions of a system on the quality of a product 14
  • 15.
    Factory Acceptance Testing(FAT)  Inspection and static and/or dynamic testing of systems or major system components to support the qualification of an equipment system conducted and documented at a supplier site. (Note : Not an obligation) 15
  • 16.
     Documented verificationthat all aspects of a facility, utility or equipment that can affect the product quality adhere to approved specifications and are correctly installed.  The process of checking/verifying the installation to ensure that the critical components meet the approved specifications and that they are installed correctly in accordance with design documentation. 16
  • 17.
     To establishthat the critical components are installed correctly and in accordance with design documentation requirements (i.e. PO’s, Contracts etc.), that supporting documentation is in place and of suitable quality.  To record the checks and verifications for critical components in Direct Impact Systems. 17
  • 18.
     Approval Page  Objectives  System Description  Responsibilities  Acceptance Criteria  Engineering Documentation Requirements  Records of Signatures  Qualification Test Equipment/Instrument List  Product Contact Materials Review  Utilities Verification  Control System Verification 18
  • 19.
     Instrument/Control DevicesVerification  Equipment Verification  Piping Installation Verification  Discrepancy/Justification and corrective Action  As built P&I Diagrams  Specifications  Conclusions  References  Modification/ Change Control  Attachments / Appendices 19
  • 20.
    Parameters  Doesthe vessel meet the design specification?  Does the agitator assembly meet the design specification?  Is the motor housing earthed?  Is the motor over current device set to correct setting?  Is all the pipe work connected?  Are all instruments installed as per P&I diagram?  Have all the temperature indicators been calibrated?  Is calibration procedure available?  Are operation and maintenance manuals available?  all electrical connections securely and safely fitted?  Is insulation complete?  Is vessel clean and free from dirt? 20
  • 21.
     After protocolexecution is complete and deviations evaluated, post execution approval is required.  Requires sign off by original signatories.  IQ execution should be complete and approved prior to the start of OQ. 21
  • 22.
    Calibration  Demonstratingthat a measuring device produces results within the specified limits of those produced by a reference standard over an appropriate range of measurements.  The devices are normally tagged and supported by a maintenance procedures. 22
  • 23.
    Site Acceptance Testing(SAT)  Inspection and dynamic testing of systems or major system components to support the qualification of an equipment system conducted at a client site. (Note : Not an obligation) 23
  • 24.
     Documented verificationthat all aspects of a facility, utility or equipment that can affect product quality operate as intended throughout all anticipated ranges. It is the process of testing to ensure that individual components and systems operate as specified, and how that information is recorded. 24
  • 25.
     To establishthrough documented testing, that all critical components and direct impact systems are capable of operating within established limits and tolerances.  To test parameters that regulate the process or product quality. To verify the proper operation of controllers, indicators, recorders, alarms and interlocks, is performed and documented during the operational qualification testing. 25
  • 26.
     Approval page  Pre-requisites  Objectives  System Description  Responsibilities  Acceptance Criteria  Records of signatures  Qualification test Equipment/Instruments list  Alarm and Interlocks test  Operation testing  Capacity testing  Power failure testing 26
  • 27.
     Sequence testing  Test data sheets  SOP’s  Conclusions  Modification / change control  Discrepancy/Justification and corrective action  Operational Qualification Summary  References  Attachments/Appendices - Verification of test instruments - Chart recordings - P&I diagrams - Printouts 27
  • 28.
    Parameters  Haveall Installation Qualification been completed for this system?  Is the system clean and free from dirt?  Is the direction of the rotation of agitator correct?  Check the operation of the agitator emergency stop?  Check the operation of all agitator controls, both on the main and local panels?  Check that the agitator in the vessel free to turn?  Pressurize the vessel and record the pressure drop for 10 min.  Perform a vacuum test and record the vacuum drop. 28
  • 29.
     Documented verificationthat all aspects of a facility, utility or equipment that can affect the product quality perform as intended in meeting the predetermined acceptance criteria. 29
  • 30.
     To integrateprocedures, personnel, systems and materials to verify that the utility / environment / equipment / support systems produces the required output. This output may be a product contact utility, sterilization condition or environment. 30
  • 31.
     Approval page  Pre-requisites  Objectives  System Description  Responsibilities  Acceptance Criteria  PQ test plan  Challenge test plan  Records of signatures  Test equipment/Instrument list  Test data sheets  SOP’s  References  Conclusions  Attachments 31
  • 32.
    Process Validation The documented verification providing a high degree of assurance that a specific process will consistently produce a product meeting its predetermined specifications and quality attributes.  The new guidelines aligns process validation activities with a product life cycle concept. 32
  • 33.
     211.42, 211.63,211.68, 211.84  211.100(a) , 211.110(a), 211.110(b)  211.160(b), 211.165(c), 211.165(d), 211.180(e) 33
  • 34.
    Life Cycle ofthe product & the process  Stage 1 – Process Design  Stage 2 – Process qualification  Stage 3 - Continuous process verification 34
  • 35.
     It isthe activity of defining the commercial manufacturing process that will be reflected in planned master production and control records.  The goal of this stage is to design a process suitable for routine commercial manufacturing that can consistently deliver a product that meets its quality attributes.  It is based on the knowledge gained through development & scale-up activities. 35
  • 36.
    During this stage,the process design is evaluated to determine if the process is capable of reproducible commercial manufacturing. The products manufactured during this stage, if acceptable , can be released for distribution. Two Aspects  Design of facility and qualification of equipment and utilities.  Process Performance Qualification ( PPQ). 36
  • 37.
    Def.: “Releasing fordistribution a lot of finished product, manufactured following a qualification protocol, that meets the standards established in the protocol, but before the entire study has been executed”.  Orphan Drugs  Specific drug for specific use  Shor t Shelf-life radio pharmaceuticals 37
  • 38.
     The goalof this stage is continual assurance that the process remains in a state of control ( the validated state) during commercial manufacture.  The cGMP requirements, specifically the collection & evaluation of information & data about the performance of the process will allow detection of undesired process variability.  This stage is also applicable for legacy products. 38
  • 39.
    Change Control Formal evaluation of the potential impact of planned modifications on the validated status of a product, process or facility. 39
  • 40.
     Training personnelfor IQ/OQ execution.  The purpose of the equipment/ system.  Use of test equipment  Applicable SOP’s  cGMP documentation of training  Document all training  Periodically review training requirements 40
  • 41.
     A documentthat summarizes and analyses the test results at the end of PQ.  Provides a conclusion about the ability of the system to consistently meet acceptance criteria.  May be a stand alone document at each stage of IQ/OQ and PQ to summarize results. 41
  • 42.
    Commissioning and Qualification Project Phases Validation Phases Technology Transfer Collecting data Conceptual Design Basic Design Preliminary VMP Detailed Design Detailed VMP Procurement Detailed planning,DQ Construction IQ Pre commissioning Commissioning OQ Process operation / Validation 42
  • 43.
    43 Introduction QualificationPersonnel Schedule Preventive Maintenance Installation Operation Process Responsibilities Training Change Control Procedures Documents Appendices
  • 44.
    The company’s overallpolicy, intentions and approach to validation, including :  Validation of production processes  Cleaning procedures  Analytical methods  In-process control test procedures  Computerized systems  Persons responsible for design, review, approval  Documentation of each validation phase 44
  • 45.
     Product validationis NOT …… - just 3 batches that meet specifications  Product validation is …… - an ongoing process to build confidence into the manufacturing activities - an ability to demonstrate consistency at any time. 45
  • 46.
     Cleaning validationis establishing documented evidence that the equipment is consistently cleaned from product, microbial and cleaning agent residues to predetermined acceptable levels. 46
  • 47.
    A written procedurefor cleaning validation which includes :  Responsibility for development, performance and approval of the validation study.  Establishment of SOP’s  Acceptance criteria - defined to prevent cross contamination - definition of residue limits 47
  • 48.
     Cleaning procedurefor each piece of equipment - Flow charts and diagrams - Cleaning agents, concentration, volume - Frequency - time left ‘dirty’ 48
  • 49.
     Sampling procedures - swabs, rinse, location  Residue limits  Analytical methods 49
  • 50.
     Validation report - Results Vs. acceptance criteria - Deviations and how handled - Conclusion that cleaning process is validated 50
  • 51.
     Major changein cleaning procedure  Change in cleaning agent  New equipment 51
  • 52.
     Knowledge ofthe materials - Potency of the drug - Pharmacological and toxic properties - Degradation products - Cleaning agents - Micro residues 52
  • 53.
    Residual Limits mustbe………….  Practical  Achievable  Verifiable  Safe FDA does not set acceptance specifications (limits). 53
  • 54.
    MAC = TDx BS x SF / LDD MAC = Maximum Allowable Carryover TD = Single Therapeutic Dose BS = Batch size of next product to be manufactured on the same equipment. SF = Safety Factor LDD = Largest Daily Dose of the next product in the same equipment. 54
  • 55.
    Ranitidine Tablets -Ibuprofen Tablets TD = Single Therapeutic Dose = 150 mg Ranitidine-Tab BS = Batch Size = 100 kg of Ibuprofen SF = Safety Factor = 1/1000 LDD = Largest Daily Dose of the next product in the same equipment = 200 mg X 5 tablets of Ibuprofen MAC = Max Allowable Carryover = 150 X 100 X 1000 x 1000 X 1/1000 X 1/1000 i.e 15000 mg in 100 kg Batch size i.e 150 mg in 1 kg = 150 ppm 55
