This document provides details on a big BIM implementation for the Abu Dhabi International Airport Midfield Terminal Building project. It outlines CCC's BIM strategy, which included employing additional BIM engineers well before the project award to allow proper training. CCC utilized established BIM tools and workflows to facilitate integration with project controls. Notable benefits realized through BIM implementation included significant cost and time savings through clash detection and material take-offs, as well as improved construction planning and coordination through use of 4D simulations and a progressive interface model.
What does BIM mean for Civil Engineers?Chun Keung Ng
BIM is a norm for the building industry. How about for infrastructures? Some countries are over confident on the implementation of BIM in both building and civil engineering industries. Is the BIM technology for infrastructures mature and easily available? Are the professionals ready for BIM?
HKIBIM Networking Seminar on April 28, 2014 at Lecture Theatre LT-01, IVE (Morrison Hill), 6 Oi Kwan Road, Wan Chai, Hong Kong.
This HKIBIM networking Seminar provides the opportunity for all attendees to interact with the speaker and the local BIM community
Guest Speaker: Mr. Igor Starkov - Co-founder and President of EcoDomus Inc.
Mr. Igor Starkov President EcoDomus, Inc.
Mr. Starkov is a computer scientist and entrepreneur with over 25 years of experience in software development, including 14 years of experience leveraging technology to improve construction project delivery and management of the built environment.
Mr. Starkov’s experience in the AEC, IT, and Facilities Management arenas and his in-depth knowledge of BIM, COBie, and Lean workflows provide him with the unique capability of creating versatile information-enabled solutions.
Mr. Starkov co-founded EcoDomus in 2008, and made the company the leading provider of Lifecycle BIM solutions. EcoDomus is working with the clients around the world, including Google, Disney, US Government (GSA), Fedearl Aviation Administration (US), University of Southern California, Singapore's Ministry of Health (MOHH), NTT Facilities (Japan), and many others.
Seminar title: Building Information Modelling for Handover and Facilities Management
Current processes of designing and building new facility, operating and maintaining it are full of gaps, and valuable data is lost. The biggest problems exist with delivery of intelligent “as-built” information to the owner of a new facility, and keeping “as-maintained” BIM up-to-date. This session will explain how to populate and maintain data created during design & construction stage (including BIM in the field), enhance it during construction and commissioning using Lean processes, and incorporate into Facility Operations & Maintenance using COBie standard. Then we will review several case studies outlining how the leading facility owners use BIM for Facility Management.
Supporting Organizations:
BSOMES - http://www.bsomes.org.hk/
BuildingSmart Hong Kong - http://www.buildingsmart.org.hk/
CIAT-HK- http://www.ciat.org.hk/
CIC - http://www.hkcic.org/
HKIS - http://www.hkis.org.hk/
HKIBIM Website: www.hkibim.org
HKIBIM Facebook: https://www.facebook.com/hkibim
HKIBIM Linkedin: http://bit.ly/HKIBIM
What does BIM mean for Civil Engineers?Chun Keung Ng
BIM is a norm for the building industry. How about for infrastructures? Some countries are over confident on the implementation of BIM in both building and civil engineering industries. Is the BIM technology for infrastructures mature and easily available? Are the professionals ready for BIM?
HKIBIM Networking Seminar on April 28, 2014 at Lecture Theatre LT-01, IVE (Morrison Hill), 6 Oi Kwan Road, Wan Chai, Hong Kong.
This HKIBIM networking Seminar provides the opportunity for all attendees to interact with the speaker and the local BIM community
Guest Speaker: Mr. Igor Starkov - Co-founder and President of EcoDomus Inc.
Mr. Igor Starkov President EcoDomus, Inc.
Mr. Starkov is a computer scientist and entrepreneur with over 25 years of experience in software development, including 14 years of experience leveraging technology to improve construction project delivery and management of the built environment.
Mr. Starkov’s experience in the AEC, IT, and Facilities Management arenas and his in-depth knowledge of BIM, COBie, and Lean workflows provide him with the unique capability of creating versatile information-enabled solutions.
Mr. Starkov co-founded EcoDomus in 2008, and made the company the leading provider of Lifecycle BIM solutions. EcoDomus is working with the clients around the world, including Google, Disney, US Government (GSA), Fedearl Aviation Administration (US), University of Southern California, Singapore's Ministry of Health (MOHH), NTT Facilities (Japan), and many others.
Seminar title: Building Information Modelling for Handover and Facilities Management
Current processes of designing and building new facility, operating and maintaining it are full of gaps, and valuable data is lost. The biggest problems exist with delivery of intelligent “as-built” information to the owner of a new facility, and keeping “as-maintained” BIM up-to-date. This session will explain how to populate and maintain data created during design & construction stage (including BIM in the field), enhance it during construction and commissioning using Lean processes, and incorporate into Facility Operations & Maintenance using COBie standard. Then we will review several case studies outlining how the leading facility owners use BIM for Facility Management.
Supporting Organizations:
BSOMES - http://www.bsomes.org.hk/
BuildingSmart Hong Kong - http://www.buildingsmart.org.hk/
CIAT-HK- http://www.ciat.org.hk/
CIC - http://www.hkcic.org/
HKIS - http://www.hkis.org.hk/
HKIBIM Website: www.hkibim.org
HKIBIM Facebook: https://www.facebook.com/hkibim
HKIBIM Linkedin: http://bit.ly/HKIBIM
Building information modeling & value to the AEC industry Part 2Stephen Au
BIM Lecture Note (4/6)
Objectives
* The challenges of Building Construction Industry
* To understand how BIM technology improve the building construction industry
* The value of using BIM for the industry
Question
* What are the benefits and limitation in applying BIM technology to the industry?
www.mtech.com.hk
Change Management For Building Information Modelling (BIM)Ir. Abdul Aziz Abas
Change Management for Building Information Modelling (BIM) addressing the challenges, advantages, implementation process strictly used for educational purposes.
Guest Lecture: "BIM & Sustainability" for the MSc. BIM & Integrated Design Summer School 2016. University of Salford, Manchester, United Kingdom
Covers:
1. Sustainable Design
2. BIM for Sustainable Design Decision Making
3. BIM for Sustainable Design Compliance (BREEAM example)
4. BIM for Sustainable Design Performance (Passivhaus example)
The new revolutionary concept of Building Information Modeling (BIM) is a digital representation of physical and functional characteristics of a facility
3d, 4d, 5d and 6d bim provide exceptional results for building construction!bimservicesindia1
BIM Services India is an eminent Architectural and Engineering consulting company provides all round solutions such as site analysis, CAD Services, planning, 3D 4D & 5D BIM Architectural and Engineering designs and other relevant consulting services to the clients from Architectural, Mechanical and Structural spheres at highly competitive cost with promising prompt delivery.
website:www.bimservicesindia.com
BIM Lecture Note (5/6)
Objectives
* The challenges of Building Construction Project
* To understand what is IPD & LEAN Construction
* To understand Asset Lifecycle Management (iBIM)
*How to apply ALM & BIM to enable LEAN Construction
Question
* How iBIM can be applied to enable IPD & LEAN Construction?
BIM for Operations
Mr. Wood Douglas, BIM Software Architect, IBM Corporation
HKIBIM-CIC BIM Conference 2014
Date: 29-Oct-2014 (Wed)
Time: 9:30 a.m. – 5:00 p.m.
Venue: Room 201 B & C, Asia World Expo, Hong Kong International Airport, Lantau, Hong Kong
Organizers:
The Hong Kong Institute of Building Information Modelling (HKIBIM)
http://www.hkibim.org
Co-organizers:
The Construction Industry Council
http://www.hkcic.org
HKTDC Hong Kong International Building and Hardware Fair
http://www.hktdc.com/fair/hkbdh-en/HKTDC-Hong-Kong-International-Building-and-Decoration-Materials-and-Hardware-Fair.html
The HKIBIM - CIC BIM Conference 2014 is the 5th Annual Conference organized by the Hong Kong Institute of Building Information Modelling (HKIBIM). It is the premier annual event for experienced AEC professionals to demonstrate the practical use of Building Information Modelling (BIM) processes using real cases. The speakers will illustrate lessons learned in practical projects so that others can improve their efficient use of BIM and advance practical knowledge.

Fiatech 2014 - Computer Simulation of Pipe Fabrication, Ramzi LabbanCCT International
Pipe spool fabrication is major component of construction operations on large industrial projects. The nature of spooling is relatively short term involving complex construction process and riddled with uncertainty due to the intrinsic unique nature of its outputs and the numerous factors affecting its activities.
With this in mind, it is important for all stakeholders to have a good grasp of the performance of pipe fabrication shops and their ability to meet the site pipe installation schedules.
The Information ChallengeManaging Construction with BIMCCT International
Presentation of Zuhair Haddad CIO, Corporate Asset and Risk Management for Consolidated Contractors Company (CCC) at the 3rd Annual BIM conference Dubai (25-26 February, 2
Building information modeling & value to the AEC industry Part 2Stephen Au
BIM Lecture Note (4/6)
Objectives
* The challenges of Building Construction Industry
* To understand how BIM technology improve the building construction industry
* The value of using BIM for the industry
Question
* What are the benefits and limitation in applying BIM technology to the industry?
www.mtech.com.hk
Change Management For Building Information Modelling (BIM)Ir. Abdul Aziz Abas
Change Management for Building Information Modelling (BIM) addressing the challenges, advantages, implementation process strictly used for educational purposes.
Guest Lecture: "BIM & Sustainability" for the MSc. BIM & Integrated Design Summer School 2016. University of Salford, Manchester, United Kingdom
Covers:
1. Sustainable Design
2. BIM for Sustainable Design Decision Making
3. BIM for Sustainable Design Compliance (BREEAM example)
4. BIM for Sustainable Design Performance (Passivhaus example)
The new revolutionary concept of Building Information Modeling (BIM) is a digital representation of physical and functional characteristics of a facility
3d, 4d, 5d and 6d bim provide exceptional results for building construction!bimservicesindia1
BIM Services India is an eminent Architectural and Engineering consulting company provides all round solutions such as site analysis, CAD Services, planning, 3D 4D & 5D BIM Architectural and Engineering designs and other relevant consulting services to the clients from Architectural, Mechanical and Structural spheres at highly competitive cost with promising prompt delivery.
website:www.bimservicesindia.com
BIM Lecture Note (5/6)
Objectives
* The challenges of Building Construction Project
* To understand what is IPD & LEAN Construction
* To understand Asset Lifecycle Management (iBIM)
*How to apply ALM & BIM to enable LEAN Construction
Question
* How iBIM can be applied to enable IPD & LEAN Construction?
BIM for Operations
Mr. Wood Douglas, BIM Software Architect, IBM Corporation
HKIBIM-CIC BIM Conference 2014
Date: 29-Oct-2014 (Wed)
Time: 9:30 a.m. – 5:00 p.m.
Venue: Room 201 B & C, Asia World Expo, Hong Kong International Airport, Lantau, Hong Kong
Organizers:
The Hong Kong Institute of Building Information Modelling (HKIBIM)
http://www.hkibim.org
Co-organizers:
The Construction Industry Council
http://www.hkcic.org
HKTDC Hong Kong International Building and Hardware Fair
http://www.hktdc.com/fair/hkbdh-en/HKTDC-Hong-Kong-International-Building-and-Decoration-Materials-and-Hardware-Fair.html
The HKIBIM - CIC BIM Conference 2014 is the 5th Annual Conference organized by the Hong Kong Institute of Building Information Modelling (HKIBIM). It is the premier annual event for experienced AEC professionals to demonstrate the practical use of Building Information Modelling (BIM) processes using real cases. The speakers will illustrate lessons learned in practical projects so that others can improve their efficient use of BIM and advance practical knowledge.
Fiatech 2014 - Computer Simulation of Pipe Fabrication, Ramzi LabbanCCT International
Pipe spool fabrication is major component of construction operations on large industrial projects. The nature of spooling is relatively short term involving complex construction process and riddled with uncertainty due to the intrinsic unique nature of its outputs and the numerous factors affecting its activities.
With this in mind, it is important for all stakeholders to have a good grasp of the performance of pipe fabrication shops and their ability to meet the site pipe installation schedules.
The Information ChallengeManaging Construction with BIMCCT International
Presentation of Zuhair Haddad CIO, Corporate Asset and Risk Management for Consolidated Contractors Company (CCC) at the 3rd Annual BIM conference Dubai (25-26 February, 2
Dossier de synthèse de pratique professionnelle (DSPP), réalisé pour le diplôme de niveau 3 en infographie multimédia / Webdesign. Titre obtenu en mai 2016.
Changing the Paradigm Rivers of Information instead of data warehousingCapgemini
Change of Paradigm: River of Information instead of data warehousing
§ New and vast data streams: Offering potential for organisations to outperform their peers
§ Changing the flow: Why IT needs to stop pushing back against local business views and start enabling them
§ Retrospective to Predictive: Shifting BI from retrospective analysis to delivering insight at the point of action
§ New thinking: Enabling an entirely new way to drive value from the information river but it demands new thinking and new skills
Integrating BIM and LEAN for Project Delivery - Construction of a Major Hospi...CCT International
Webinar presented by Mr. Zuhair Haddad, CCT's Chairman for the Lean Construction Institute on 1 September 2016.
Hospitals are ecosystems of diverse functions: laboratories, imaging units, ERs, surgery and operating rooms, inpatient quarters, etc. This makes building them one of the most complex tasks, specifically room completion systems as each set of rooms have their own furnishing and finishing requirements. This entails the existence of several number of trades, where coordination grows exponentially in importance. King Hussein Cancer Center in Jordan is a prime example with fast track requirements (3 years delivery) which increase the complexity further.
Join in this webinar Consolidated Contractors Company (CCC), a leading global construction contractor who will share the above case study where BIM, advanced work packaging and Lean were implemented in an integrated approach to manage the finishing activities for the hospital. The presenter will share some of key drivers for the success of this implementation:
• BIM authoring requirements to suit project controls

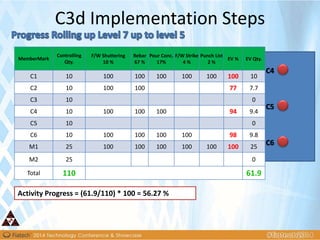

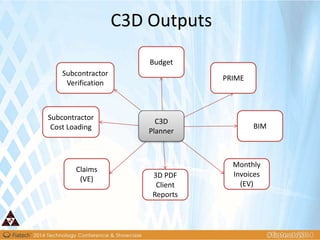

• Leveraging BIM to manage schedule, cost, sub-contractors, and material delivery.
• Installation Work Packages (IWPs) creation
• IWPs management using Lean approach
• Collaboration using BIM to support Lean processes
• Lessons learned.
About the Presenter:
Zuhair Haddad is the CIO, Corporate Asset and Risk Management for Consolidated Contractors Company (CCC). He is in charge of mapping out and implementing the Project Control IT and Communication strategy for CCC group as well as directly overseeing CCC’s Information Systems, Corporate Risk, Communication and E-procurement Departments. He also leads the Plants Machinery and Vehicles (PMV) Department which manages CCC’s extensive fleet of construction equipment. Zuhair holds a Masters in Construction Management from Stanford University and a Bachelor of Science from the California State University of Chico in Civil Engineering. In 2014, Zuhair and two other inventors were granted a US Patent for their invention entitled: “System and method for hybrid solid and surface modeling for computer-aided design environments."
Whether you're just starting out, or have been around for years, there are always opportunities to get more out of LinkedIn for your small business. Here are 5 simple things that can help take your efforts to the next level.
Leveraging C3D® to Ensure Compliance of Site Execution TeamsCCT International
Presented by Dr. Amr El-Sersy on October 10 2017, at the 2017 AWP conference in Houston, Texas, USA.
Dr. Amr El-Sersy is CCT's VP of Marketing and Business Consulting Services.
Delivering Asset Management for Infrastructure Projects by Liam Gallagher, Ja...AVEVA Group plc
How do you fully control and manage the development of the non-graphical engineering data connected to the physical assets? Liam Gallagher, Jacobs, discusses ‘Delivering Asset Management for Infrastructure Projects’ and how integrated AVEVA Technologies have enabled JACOBS to have a single source of truth for project data.
Discover how one of the world’s largest and most diverse providers of technical, professional, and construction services use AVEVA to transform their business. Visit www.aveva.com to get more information today.
AF-1438: Transportation MUG: CCC's Use of Maximo for Fleet Management on Infr...CCT International
CCT International's presentation at IBM InterConnect 2015: The Premier Cloud & Mobile Conference.
Presented by Khaled Al Shami, EAM Solutions Manager
- See more at: http://www.cctintl.com/news/cct-international-present-ibm-interconnect-2015#sthash.v8MuiCA6.dpuf
FIATECH and COMIT Conference - 30-31 October, 2014 UK
The conference presented by Fiatech and COMIT entitled " Efficiency Through Digital Projects" aims to illustrate and highlight the effectiveness of the three prominent elements in construction (People, Process and Technology) when integrated within digital projects. Mr. Firas Hijazi, Manager IS Projects Automation and Controls will be delivering a presentation entitled "Digital Processing at the Workface-Interactively Natural" featuring the use and benefits of data capture systems being used in the Abu Dhabi Midfield Terminal airport project. His focus will be on digital pens and its significant results in speeding up the process of gathering data and increasing accuracy throughout the project life-cycle. Moreover, he will emphasize on the ROI based on a scenario analysis of the actual project, showcasing productivity benefits of digital pen versus the traditional "pen and paper" process
Hybrid optimization of pumped hydro system and solar- Engr. Abdul-Azeez.pdffxintegritypublishin
Advancements in technology unveil a myriad of electrical and electronic breakthroughs geared towards efficiently harnessing limited resources to meet human energy demands. The optimization of hybrid solar PV panels and pumped hydro energy supply systems plays a pivotal role in utilizing natural resources effectively. This initiative not only benefits humanity but also fosters environmental sustainability. The study investigated the design optimization of these hybrid systems, focusing on understanding solar radiation patterns, identifying geographical influences on solar radiation, formulating a mathematical model for system optimization, and determining the optimal configuration of PV panels and pumped hydro storage. Through a comparative analysis approach and eight weeks of data collection, the study addressed key research questions related to solar radiation patterns and optimal system design. The findings highlighted regions with heightened solar radiation levels, showcasing substantial potential for power generation and emphasizing the system's efficiency. Optimizing system design significantly boosted power generation, promoted renewable energy utilization, and enhanced energy storage capacity. The study underscored the benefits of optimizing hybrid solar PV panels and pumped hydro energy supply systems for sustainable energy usage. Optimizing the design of solar PV panels and pumped hydro energy supply systems as examined across diverse climatic conditions in a developing country, not only enhances power generation but also improves the integration of renewable energy sources and boosts energy storage capacities, particularly beneficial for less economically prosperous regions. Additionally, the study provides valuable insights for advancing energy research in economically viable areas. Recommendations included conducting site-specific assessments, utilizing advanced modeling tools, implementing regular maintenance protocols, and enhancing communication among system components.
Cosmetic shop management system project report.pdfKamal Acharya
Buying new cosmetic products is difficult. It can even be scary for those who have sensitive skin and are prone to skin trouble. The information needed to alleviate this problem is on the back of each product, but it's thought to interpret those ingredient lists unless you have a background in chemistry.
Instead of buying and hoping for the best, we can use data science to help us predict which products may be good fits for us. It includes various function programs to do the above mentioned tasks.
Data file handling has been effectively used in the program.
The automated cosmetic shop management system should deal with the automation of general workflow and administration process of the shop. The main processes of the system focus on customer's request where the system is able to search the most appropriate products and deliver it to the customers. It should help the employees to quickly identify the list of cosmetic product that have reached the minimum quantity and also keep a track of expired date for each cosmetic product. It should help the employees to find the rack number in which the product is placed.It is also Faster and more efficient way.
Hierarchical Digital Twin of a Naval Power SystemKerry Sado
A hierarchical digital twin of a Naval DC power system has been developed and experimentally verified. Similar to other state-of-the-art digital twins, this technology creates a digital replica of the physical system executed in real-time or faster, which can modify hardware controls. However, its advantage stems from distributing computational efforts by utilizing a hierarchical structure composed of lower-level digital twin blocks and a higher-level system digital twin. Each digital twin block is associated with a physical subsystem of the hardware and communicates with a singular system digital twin, which creates a system-level response. By extracting information from each level of the hierarchy, power system controls of the hardware were reconfigured autonomously. This hierarchical digital twin development offers several advantages over other digital twins, particularly in the field of naval power systems. The hierarchical structure allows for greater computational efficiency and scalability while the ability to autonomously reconfigure hardware controls offers increased flexibility and responsiveness. The hierarchical decomposition and models utilized were well aligned with the physical twin, as indicated by the maximum deviations between the developed digital twin hierarchy and the hardware.
NO1 Uk best vashikaran specialist in delhi vashikaran baba near me online vas...Amil Baba Dawood bangali
Contact with Dawood Bhai Just call on +92322-6382012 and we'll help you. We'll solve all your problems within 12 to 24 hours and with 101% guarantee and with astrology systematic. If you want to take any personal or professional advice then also you can call us on +92322-6382012 , ONLINE LOVE PROBLEM & Other all types of Daily Life Problem's.Then CALL or WHATSAPP us on +92322-6382012 and Get all these problems solutions here by Amil Baba DAWOOD BANGALI
#vashikaranspecialist #astrologer #palmistry #amliyaat #taweez #manpasandshadi #horoscope #spiritual #lovelife #lovespell #marriagespell#aamilbabainpakistan #amilbabainkarachi #powerfullblackmagicspell #kalajadumantarspecialist #realamilbaba #AmilbabainPakistan #astrologerincanada #astrologerindubai #lovespellsmaster #kalajaduspecialist #lovespellsthatwork #aamilbabainlahore#blackmagicformarriage #aamilbaba #kalajadu #kalailam #taweez #wazifaexpert #jadumantar #vashikaranspecialist #astrologer #palmistry #amliyaat #taweez #manpasandshadi #horoscope #spiritual #lovelife #lovespell #marriagespell#aamilbabainpakistan #amilbabainkarachi #powerfullblackmagicspell #kalajadumantarspecialist #realamilbaba #AmilbabainPakistan #astrologerincanada #astrologerindubai #lovespellsmaster #kalajaduspecialist #lovespellsthatwork #aamilbabainlahore #blackmagicforlove #blackmagicformarriage #aamilbaba #kalajadu #kalailam #taweez #wazifaexpert #jadumantar #vashikaranspecialist #astrologer #palmistry #amliyaat #taweez #manpasandshadi #horoscope #spiritual #lovelife #lovespell #marriagespell#aamilbabainpakistan #amilbabainkarachi #powerfullblackmagicspell #kalajadumantarspecialist #realamilbaba #AmilbabainPakistan #astrologerincanada #astrologerindubai #lovespellsmaster #kalajaduspecialist #lovespellsthatwork #aamilbabainlahore #Amilbabainuk #amilbabainspain #amilbabaindubai #Amilbabainnorway #amilbabainkrachi #amilbabainlahore #amilbabaingujranwalan #amilbabainislamabad
Final project report on grocery store management system..pdfKamal Acharya
In today’s fast-changing business environment, it’s extremely important to be able to respond to client needs in the most effective and timely manner. If your customers wish to see your business online and have instant access to your products or services.
Online Grocery Store is an e-commerce website, which retails various grocery products. This project allows viewing various products available enables registered users to purchase desired products instantly using Paytm, UPI payment processor (Instant Pay) and also can place order by using Cash on Delivery (Pay Later) option. This project provides an easy access to Administrators and Managers to view orders placed using Pay Later and Instant Pay options.
In order to develop an e-commerce website, a number of Technologies must be studied and understood. These include multi-tiered architecture, server and client-side scripting techniques, implementation technologies, programming language (such as PHP, HTML, CSS, JavaScript) and MySQL relational databases. This is a project with the objective to develop a basic website where a consumer is provided with a shopping cart website and also to know about the technologies used to develop such a website.
This document will discuss each of the underlying technologies to create and implement an e- commerce website.
Overview of the fundamental roles in Hydropower generation and the components involved in wider Electrical Engineering.
This paper presents the design and construction of hydroelectric dams from the hydrologist’s survey of the valley before construction, all aspects and involved disciplines, fluid dynamics, structural engineering, generation and mains frequency regulation to the very transmission of power through the network in the United Kingdom.
Author: Robbie Edward Sayers
Collaborators and co editors: Charlie Sims and Connor Healey.
(C) 2024 Robbie E. Sayers
About
Indigenized remote control interface card suitable for MAFI system CCR equipment. Compatible for IDM8000 CCR. Backplane mounted serial and TCP/Ethernet communication module for CCR remote access. IDM 8000 CCR remote control on serial and TCP protocol.
• Remote control: Parallel or serial interface.
• Compatible with MAFI CCR system.
• Compatible with IDM8000 CCR.
• Compatible with Backplane mount serial communication.
• Compatible with commercial and Defence aviation CCR system.
• Remote control system for accessing CCR and allied system over serial or TCP.
• Indigenized local Support/presence in India.
• Easy in configuration using DIP switches.
Technical Specifications
Indigenized remote control interface card suitable for MAFI system CCR equipment. Compatible for IDM8000 CCR. Backplane mounted serial and TCP/Ethernet communication module for CCR remote access. IDM 8000 CCR remote control on serial and TCP protocol.
Key Features
Indigenized remote control interface card suitable for MAFI system CCR equipment. Compatible for IDM8000 CCR. Backplane mounted serial and TCP/Ethernet communication module for CCR remote access. IDM 8000 CCR remote control on serial and TCP protocol.
• Remote control: Parallel or serial interface
• Compatible with MAFI CCR system
• Copatiable with IDM8000 CCR
• Compatible with Backplane mount serial communication.
• Compatible with commercial and Defence aviation CCR system.
• Remote control system for accessing CCR and allied system over serial or TCP.
• Indigenized local Support/presence in India.
Application
• Remote control: Parallel or serial interface.
• Compatible with MAFI CCR system.
• Compatible with IDM8000 CCR.
• Compatible with Backplane mount serial communication.
• Compatible with commercial and Defence aviation CCR system.
• Remote control system for accessing CCR and allied system over serial or TCP.
• Indigenized local Support/presence in India.
• Easy in configuration using DIP switches.
Welcome to WIPAC Monthly the magazine brought to you by the LinkedIn Group Water Industry Process Automation & Control.
In this month's edition, along with this month's industry news to celebrate the 13 years since the group was created we have articles including
A case study of the used of Advanced Process Control at the Wastewater Treatment works at Lleida in Spain
A look back on an article on smart wastewater networks in order to see how the industry has measured up in the interim around the adoption of Digital Transformation in the Water Industry.
Water Industry Process Automation and Control Monthly - May 2024.pdf
Fiatech 2014 - Big BIM Implementation, Zuhair Haddad
1. Master Title
Click to edit Master subtitle style
Big BIM implementation
Abu Dhabi International Airport - Midfield Terminal Building
Zuhair Haddad
Chief Information Officer, CCC
2. Emiral Project
Moretti, Algeria
Cost: $230 Million
Built up Area: 60,000 m2
Abu Dhabi Plaza
Astana, Kazakstan
Cost: $1.3 Billion
Built up Area: 510,000 m2
Midfield Terminal Building
Abu Dhabi, UAE
Lusail Multi-Purpose Hall
Lusail, Qatar
C Morocco ost: $315 Million
Built up Area: 107,650 m2
The Nile Corniche Project
Cairo, Egypt
Cost: $450 Million
Built up Area: 70,000 m2
Dukhan Highway Project
Doha, Qatar
Cost: $370 Million
Road Length: 66 km
F-Ring Road Project
Doha, Qatar
Cost: $230 Million
Road Length: 9 km
Multipurpose Admin Complex
Doha, Qatar
Cost: $205 Million
Built up Area: 34,820 m2
Khlifa Bin Zayed Al Nahyan
Specialized Hospital
Casablanca, Morocco
Cost: $100 Million
Built up Area: 42,000 m2
Doha’s New Port Project
Doha, Qatar
Cost: $292 Million

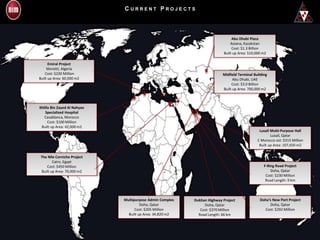

C U R R E N T PR O J E C T S
3. Abu Dhabi Plaza
Astana, Kazakstan
Cost: $1.3 Billion
Built up Area: 510,000 m2
Midfield Terminal Building
Abu Dhabi, UAE
Cost: $3.0 Billion
Built up Area: 700,000 m2
Lusail Multi-Purpose Hall
Lusail, Qatar
C Morocco ost: $315 Million
Built up Area: 107,650 m2
The Nile Corniche Project
Cairo, Egypt
Cost: $450 Million
Built up Area: 70,000 m2
Dukhan Highway Project
Doha, Qatar
Cost: $370 Million
Road Length: 66 km
F-Ring Road Project
Doha, Qatar
Cost: $230 Million
Road Length: 9 km
Multipurpose Admin Complex
Doha, Qatar
Cost: $205 Million
Built up Area: 34,820 m2
Khlifa Bin Zayed Al Nahyan
Specialized Hospital
Casablanca, Morocco
Cost: $100 Million
Built up Area: 42,000 m2
Emiral Project
Moretti, Algeria
Cost: $230 Million
Built up Area: 60,000 m2
Doha’s New Port Project
Doha, Qatar
Cost: $292 Million
C U R R E N T PR O J E C T S
4.

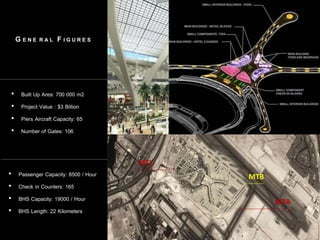

5. G E N E R A L F I G U R E S
• Built Up Area: 700 000 m2
• Project Value : $3 Billion
• Piers Aircraft Capacity: 65
• Number of Gates: 106
• Passenger Capacity: 8500 / Hour
• Check in Counters: 165
• BHS Capacity: 19000 / Hour
• BHS Length: 22 Kilometers
MTL
MTA
MTB

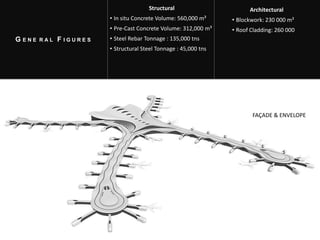

6. CENTRAL AREA
CONCRETE STRUCTURESTEEL STRUCTUREFAÇADE & ENVELOPE
Structural
• In situ Concrete Volume: 560,000 m³
• Pre-Cast Concrete Volume: 312,000 m³
• Steel Rebar Tonnage : 135,000 tns
• Structural Steel Tonnage : 45,000 tns
Architectural
• Blockwork: 230 000 m²
• Roof Cladding: 260 000
G E N E R A L F I G U R E S

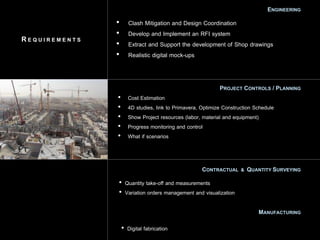

7. RE Q U I R E M E N T S
ENGINEERING
• Clash Mitigation and Design Coordination
• Develop and Implement an RFI system
• Extract and Support the development of Shop drawings
• Realistic digital mock-ups
• Cost Estimation
• 4D studies, link to Primavera, Optimize Construction Schedule
• Show Project resources (labor, material and equipment)
• Progress monitoring and control
• What if scenarios
PROJECT CONTROLS / PLANNING
• Quantity take-off and measurements
• Variation orders management and visualization
MANUFACTURING
CONTRACTUAL & QUANTITY SURVEYING
• Digital fabrication

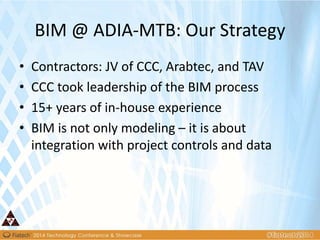

8. BIM @ ADIA-MTB: Our Strategy
• Contractors: JV of CCC, Arabtec, and TAV
• CCC took leadership of the BIM process
• 15+ years of in-house experience
• BIM is not only modeling – it is about
integration with project controls and data

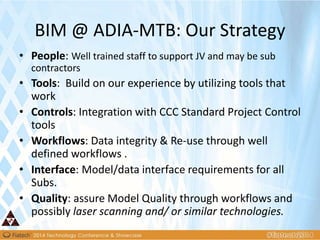

9. BIM @ ADIA-MTB: Our Strategy
• People: Well trained staff to support JV and may be sub
contractors
• Tools: Build on our experience by utilizing tools that
work
• Controls: Integration with CCC Standard Project Control
tools
• Workflows: Data integrity & Re-use through well
defined workflows .
• Interface: Model/data interface requirements for all
Subs.
• Quality: assure Model Quality through workflows and
possibly laser scanning and/ or similar technologies.
10. BIM @ ADIA-MTB: Our Strategy

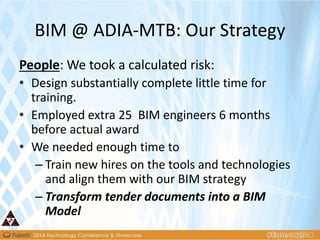

People: We took a calculated risk:
• Design substantially complete little time for
training.
• Employed extra 25 BIM engineers 6 months
before actual award
• We needed enough time to
– Train new hires on the tools and technologies
and align them with our BIM strategy
– Transform tender documents into a BIM
Model
11. BIM @ ADIA-MTB: Our Strategy

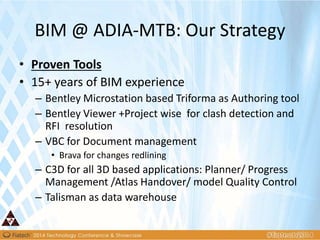

• Proven Tools
• 15+ years of BIM experience
– Bentley Microstation based Triforma as Authoring tool
– Bentley Viewer +Project wise for clash detection and
RFI resolution
– VBC for Document management
• Brava for changes redlining

– C3D for all 3D based applications: Planner/ Progress
Management /Atlas Handover/ model Quality Control
– Talisman as data warehouse
12. Notable BIM Implementations @ CCC
• Abu Dhabi International Airport - Midfield Terminal Building
• Dubai Mall Project – Dubai, UAE
• Nile Cornice Project – Cairo, Egypt
• F-Ring Road – Doha, Qatar
• Dukhan Highway Project – Qatar
• Qatar Faculty of Islamic Studies – Doha, Qatar
• Lusail Multi-Purpose Hall – Qatar
• Princess Noura University – Riyadh, Saudi Arabia
• Muscat International Airport Phase #1 – Muscat, Oman
• Khalifa Hospital – Casablanca, Morocco
• Mubadala Building – Abu Dhabi, UAE
• Carnegie Mellon University – Doha, Qatar

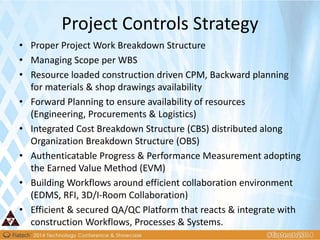

13. • Proper Project Work Breakdown Structure
• Managing Scope per WBS
• Resource loaded construction driven CPM, Backward planning
for materials & shop drawings availability
• Forward Planning to ensure availability of resources
(Engineering, Procurements & Logistics)
• Integrated Cost Breakdown Structure (CBS) distributed along
Organization Breakdown Structure (OBS)
• Authenticatable Progress & Performance Measurement adopting
the Earned Value Method (EVM)
• Building Workflows around efficient collaboration environment
(EDMS, RFI, 3D/I-Room Collaboration)
• Efficient & secured QA/QC Platform that reacts & integrate with
construction Workflows, Processes & Systems.
Project Controls Strategy

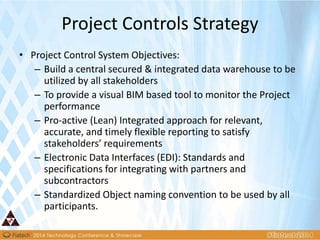

14. • Project Control System Objectives:
– Build a central secured & integrated data warehouse to be
utilized by all stakeholders
– To provide a visual BIM based tool to monitor the Project
performance
– Pro-active (Lean) Integrated approach for relevant,
accurate, and timely flexible reporting to satisfy
stakeholders’ requirements
– Electronic Data Interfaces (EDI): Standards and
specifications for integrating with partners and
subcontractors
– Standardized Object naming convention to be used by all
participants.
Project Controls Strategy

15. DRWGs & Specs
Variations
RFIs
Submittals
MTO
Estimation
Budget
Procurement
Purchase
Expediting
BOQ Work
Groups 3D Model
Building Blocks
Direct Cost
Estimate
Budget/
Cost
Codes
Time Sheet
Actual Man-hours
PO Register
information
Planning / PRIMAVERA
MTO, Objects
& Work flows
Planned
Dates
Actual
Progress
TALISMAN
VBC
REPORTS
REPORTS
BOQ
WBS
Discipline
Codes
(Category)
Actual Cost
Subcontractors /
Suppliers
BBS
Shop DWGs,
Software, S/Cs,
Suppliers
MTO
Variations
MTO
WBS &
Cost Code
WBS
QC
Certification
Sub-Contractors and suppliers
should be contractually obliged
to deliver detailed BIM info. as
per the agreed EDI
Visual Controls
Doc Reg.
Submittals
Doc
Reg.
Material Delivery
SMR, PO,
Expediting Info
Integration with other
EDMS’s & procurement
systems
Project Control Team
Material
Control
Batching
Quality
Control
Quantity
Take offs
Engineering Design
C3D Planner / Simulation / Pyramid / Projmon
Document
Control
Collaboration
Transmittals RFI etc
Accounting
3D Model
Cost
Report
Progress
Report
Payment
Certificate
Payroll
ATLAS
Tags
Site
Invoices, JVs
SMR, PO,
MRR
DPMS
Material
request
Reinforced
Concrete
MTO
Project Controls Systems

16. BIM @ ADIA-MTB: Our Strategy
• Once awarded we were able to mobilize
immediately to site and hit the ground running:
– Ready RFI’s
– Design Discrepancies
– Scope Management
– Ready Environment for constructability studies
– Electronic Data Interchange (EDI):
• Project Work Breakdown Structures (WBS)
• CAD / Model naming convention and exchange procedure
• Object Tagging standards and asset management
• Object attributes and database requirements
• Collaboration and integration of workflows

17. E D I
ELECTRONIC DATA INTERCHANGE
A I M
Arrangement and transformation of the BIM
CAD files and information created by the
JV & Subcontractors to project (TCAJV)
BIM platform
B E N E F I T S
• Common language for graphical and textual
data exchange
• Interoperability
• Integration of all BIM information from all
disciplines
• Data integrity and lifecycle management
Integration Workflow Between Authoring Tools and TCAJV In House Application

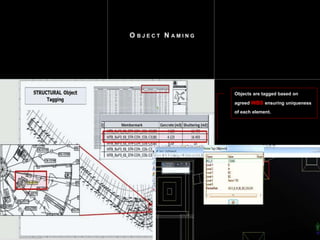

18. O B J E C T N A M I N G
Objects are tagged based on
agreed WBS ensuring uniqueness
of each element.

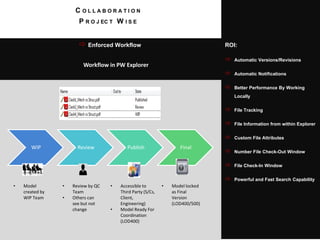

19. WIP Review Publish Final
• Model
created by
WIP Team
• Review by QC
Team
• Others can
see but not
change
• Accessible to
Third Party (S/Cs,
Client,
Engineering)
• Model Ready For
Coordination
(LOD400)
• Model locked
as Final
Version
(LOD400/500)
C O L L A B O R A T I O N
P R O J EC T W I S E
Enforced Workflow
Workflow in PW Explorer
ROI:
Automatic Versions/Revisions
Automatic Notifications
Better Performance By Working
Locally
File Tracking
File Information from within Explorer
Custom File Attributes
Number File Check-Out Window
File Check-In Window
Powerful and Fast Search Capability

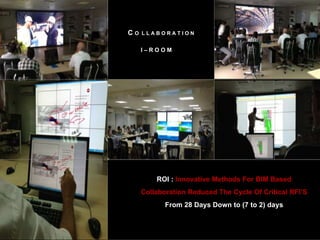

20. C O L L A B O R A T I O N
I – R O O M
ROI : Innovative Methods For BIM Based
Collaboration Reduced The Cycle Of Critical RFI’S
From 28 Days Down to (7 to 2) days

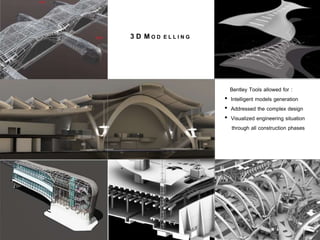

21. 3 D MO D E L L I N G
Bentley Tools allowed for :
• Intelligent models generation
• Addressed the complex design
• Visualized engineering situation
through all construction phases

22. B I M B A S E D
M A T E R I A L T A K E O F F
ROI : BIM Methods Reduced The Number of Quantity Surveying Team from
60 to 6 - 90% Saving in Direct Cost

23. C L A S H D E T E C T I O N C L A S H E S T A G S
NO CLASH DETECTE
D
CLASHES
(NO)
DIRECT
TIME
(HR)
DIRECT
COST($)
IN-
DIRECT
TIME(H
R)
IN- DIRECT
COST($)
TOTAL
TIME
(HR)
TOTAL
COST ($)
1 FACADE EMBEDS SLAB 112 32 30 18 20 5600 147840
2 FACADE EMBEDS S.STR
EMBEDS
90 26 12 24 16 4500 62640
3 FACADE EMBEDS PIPELINE 26 38 15 32 20 1820 31460
4 FACADE EMBEDS REBAR’S 250 4 20 4 15 2000 35000
5 CW PANEL & FASCIA PANEL 292 25 18 15 25 11680 240900
6 FAÇADE MULLION & STEEL
COLUMN PLATE
190 30 24 18 30 9120 239400
7 FAÇADE MULLION PLATE AND 350 24 18 24 20 16800 319200
Table Of Conventional Procedure Charges In Solving Clashes Between The Façade And Other Disciplines
ROI : BIM Workflows saved Almost USD 1 million and more than 51000 MHRS in Avoiding
Façade Clashes Only

24. Blockwork Extraction for Level Basement 2
Comparative Table of Work Time / Cost Impact / Accuracy Levels
ROI : BIM Workflows saved 1123.5 hrs = 118.36 ~ 119 days and $65,000 per Zone
25. MS
E&M Ceiling (SEI)
BIM
SD
MEP
MS
AECOM
FABRICATION
DELIVERY
CONSTRUCTION 10-Aug-13
Main Façade Mullions
BIM
SD
AECOM
FABRICATION
DELIVERY
CONSTRUCTION
E&M Ceiling (SEI)
BIMSD
MEP
MS
AECOM
FABRICATION
DELIVERY
CONSTRUCTION 10-Aug-13
L0.0 Facade Mullions Supports
BIM
SD
MEP
MS
AECOM
FABRICATION
DELIVERY
CONSTRUCTION 16-Jun-13
Blast Columns Erection
BIM
SD
MEP
MS
AECOM
FABRICATION
DELIVERY
CONSTRUCTION 12-Jun-13
MTC-2 Plate Girder Erection
BIM
SD
MEP
MS
AECOM
FABRICATION
DELIVERY
CONSTRUCTION 28-May-13
MEP
4 D S I M U L A T I O N

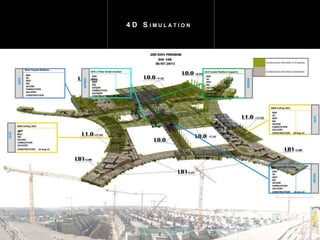

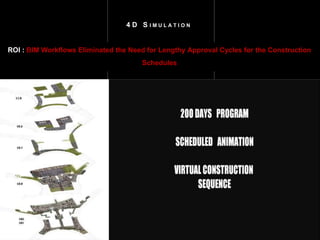

26. 4 D S I M U L A T I O N
ROI : BIM Workflows Eliminated the Need for Lengthy Approval Cycles for the Construction
Schedules

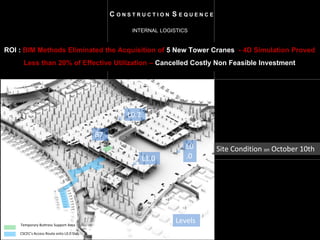

27. C O N S T R U C T I O N S E Q U E N C E
INTERNAL LOGISTICS
B7
Site Condition on October 10th
L1.0
L0.2
L0
.0
Temporary Buttress Support Area
CSCEC’s Access Route onto L0.0 Slab
Levels
ROI : BIM Methods Eliminated the Acquisition of 5 New Tower Cranes - 4D Simulation Proved
Less than 20% of Effective Utilization – Cancelled Costly Non Feasible Investment

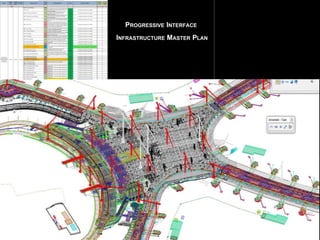

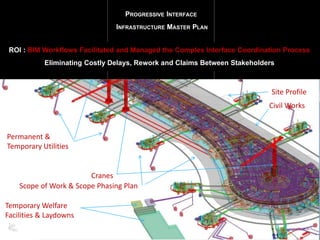

29. PROGRESSIVE INTERFACE
INFRASTRUCTURE MASTER PLAN
Cranes
Permanent &
Temporary Utilities
Temporary Welfare
Facilities & Laydowns
Site Profile
Civil Works
Scope of Work & Scope Phasing Plan
ROI : BIM Workflows Facilitated and Managed the Complex Interface Coordination Process
Eliminating Costly Delays, Rework and Claims Between Stakeholders

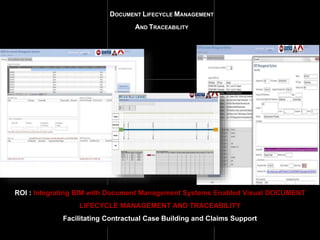

30. DOCUMENT LIFECYCLE MANAGEMENT
AND TRACEABILITY
ROI : Integrating BIM with Document Management Systems Enabled Visual DOCUMENT
LIFECYCLE MANAGEMENT AND TRACEABILITY
Facilitating Contractual Case Building and Claims Support

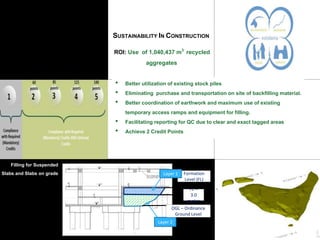

31. • Better utilization of existing stock piles
• Eliminating purchase and transportation on site of backfilling material.
• Better coordination of earthwork and maximum use of existing
temporary access ramps and equipment for filling.
• Facilitating reporting for QC due to clear and exact tagged areas
• Achieve 2 Credit Points
Formation
Level (FL)
FL –
3.0
meter
Layer 2
Layer 1
OGL – Ordinance
Ground Level
ROI: Use of 1,040,437 m3 recycled
aggregates
Filling for Suspended
Slabs and Slabs on grade
SUSTAINABILITY IN CONSTRUCTION

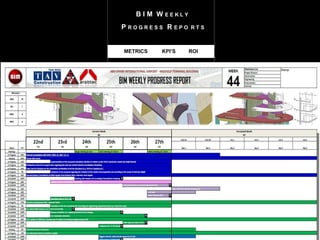

32. B I M W E E K L Y
P R O G R E S S R E P O R T S
METRICS KPI’S ROI

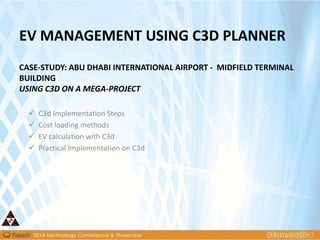

33. EV MANAGEMENT USING C3D PLANNER
CASE-STUDY: ABU DHABI INTERNATIONAL AIRPORT - MIDFIELD TERMINAL
BUILDING
USING C3D ON A MEGA-PROJECT
C3d Implementation Steps

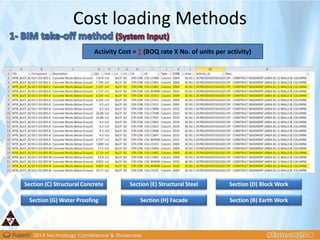

Cost loading methods
EV calculation with C3d
Practical Implementation on C3d
34. • 3D based development environment
• Interactive visual data integration & reporting
system

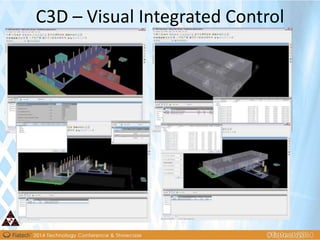

C3D – Visual Integrated Control
Main Functions:
– Interoperability with different BIM platforms:
Triforma, PDS, PDMS, CADWorks, Revit etc.
– Link CAD Object to data warehouse
– Graphical representation for Query results
using colorization, blinking, graying, or
Manhattan panels
– 3D standard navigation functionalities and 4D
simulation
– Ease of customization
Vertical Applications:
– Quanto - Visual Queries for Estimation &
MTO
– Chronos - Linking Primavera Plan to 3D
Model
– Planner – Detailed planning of site activities,
work packaging, progress management &
reporting
– Atlas – Visual QC and Handover system
– Visual Reporting - Progress Reporting by
Colorization
– 4D Simulation

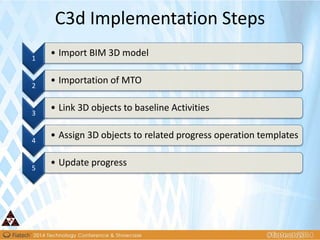

36. 1

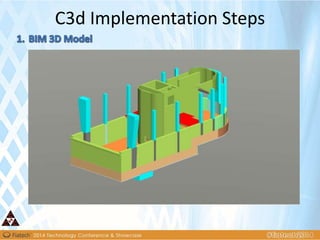

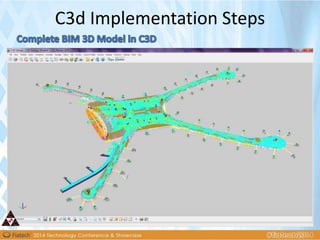

• Import BIM 3D model
2

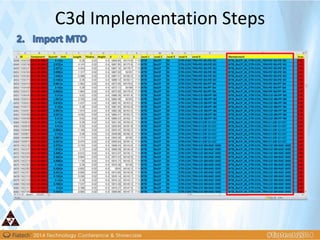

• Importation of MTO
3

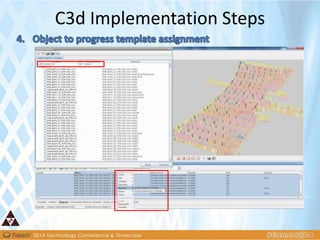

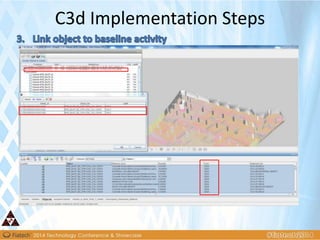

• Link 3D objects to baseline Activities
4
• Assign 3D objects to related progress operation templates
5

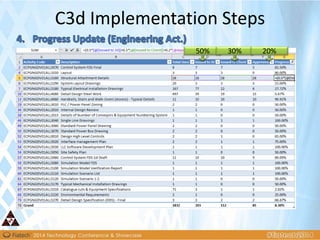

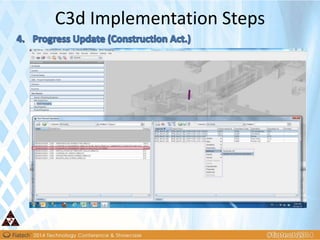

• Update progress
C3d Implementation Steps

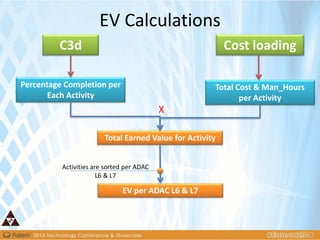

50. EV Calculations
C3d Cost loading
Percentage Completion per
Each Activity
Total Cost & Man_Hours
per Activity
Total Earned Value for Activity
EV per ADAC L6 & L7
Activities are sorted per ADAC
L6 & L7
X
51. Model
Activities
Progress %
Method of
Measurement
3D Object
Method of
Measurement
BOQ
P6
Site Progress
BIM Model C3d
% Progress & Earned Value
3D PDF Colorized
Progress
Activities completion
percentage (P6)
Monthly Payment
Application (EV)

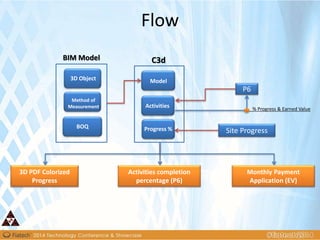

Flow
53. Recognition for BIM @ CCC
• Two articles in BIM Journal about MTB BIM Implementation in
January 2014 and December 2013
• Winner – Bentley’s “Be Inspired” Special Recognition Award
2013 - Innovation in Comprehensive BIM for MTB BIM
Implementation
• CCC Organizes and Sponsors annually the Middle East BIM
Conference since 2011
• Awarded for BIM Implementation at the Dubai Mall Project at
Bentley Conference 2008
• Martin Fisher: “one of the most advanced BIM
implementation I have seen” CIFE Meeting Fall 2013
