BIM Project ExecutionBIM Project Execution
Stephen AUStephen AU
Oct. 17, 2013
Lecture Class BRE398: Building Information Modeling
BRE398: Building Information Modeling

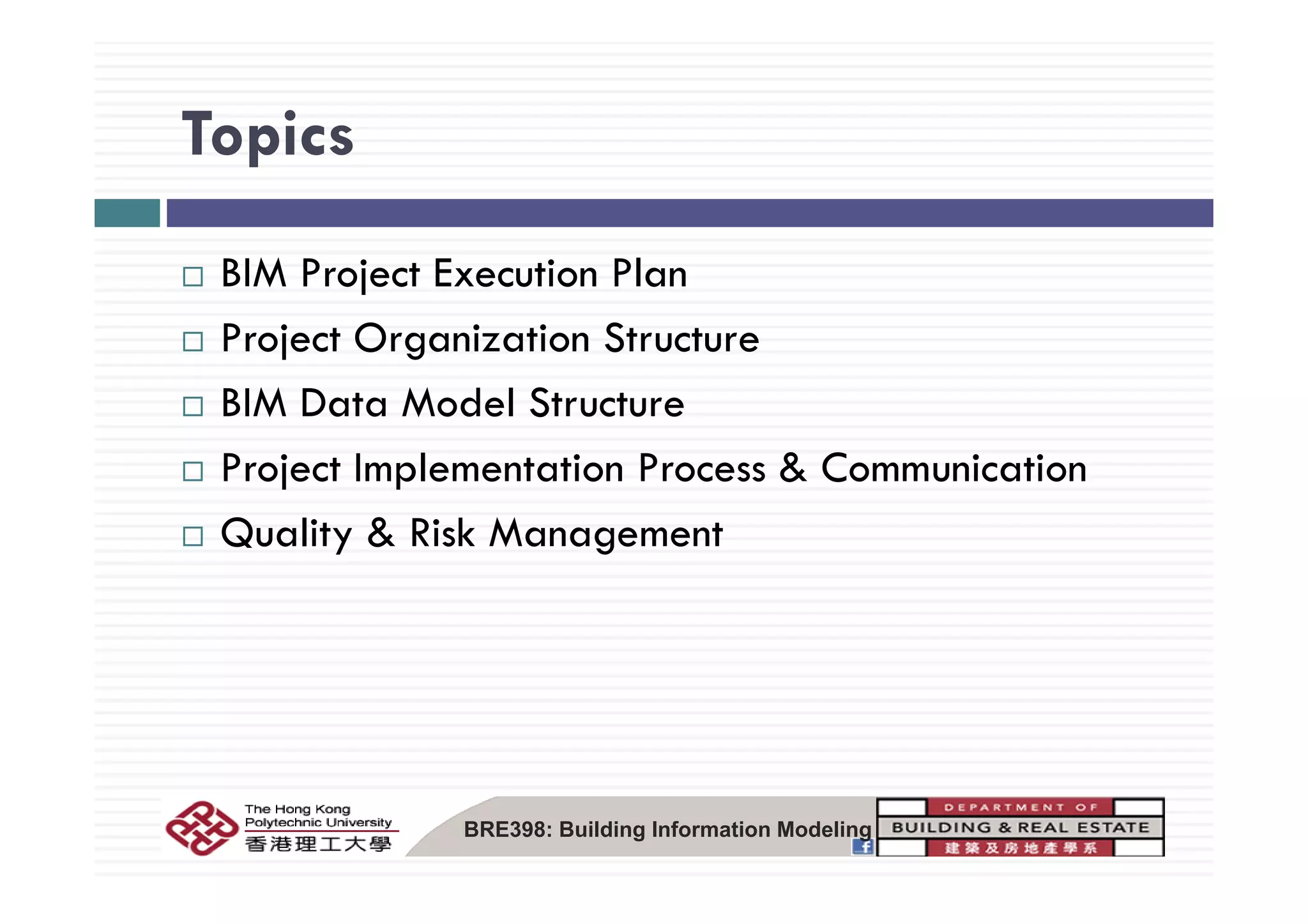

TopicsTopics
BIM Project Execution Plan
Project Organization Structurej g
BIM Data Model Structure
P j t I l t ti P & C i tiProject Implementation Process & Communication
Quality & Risk Management
BRE398: Building Information Modeling

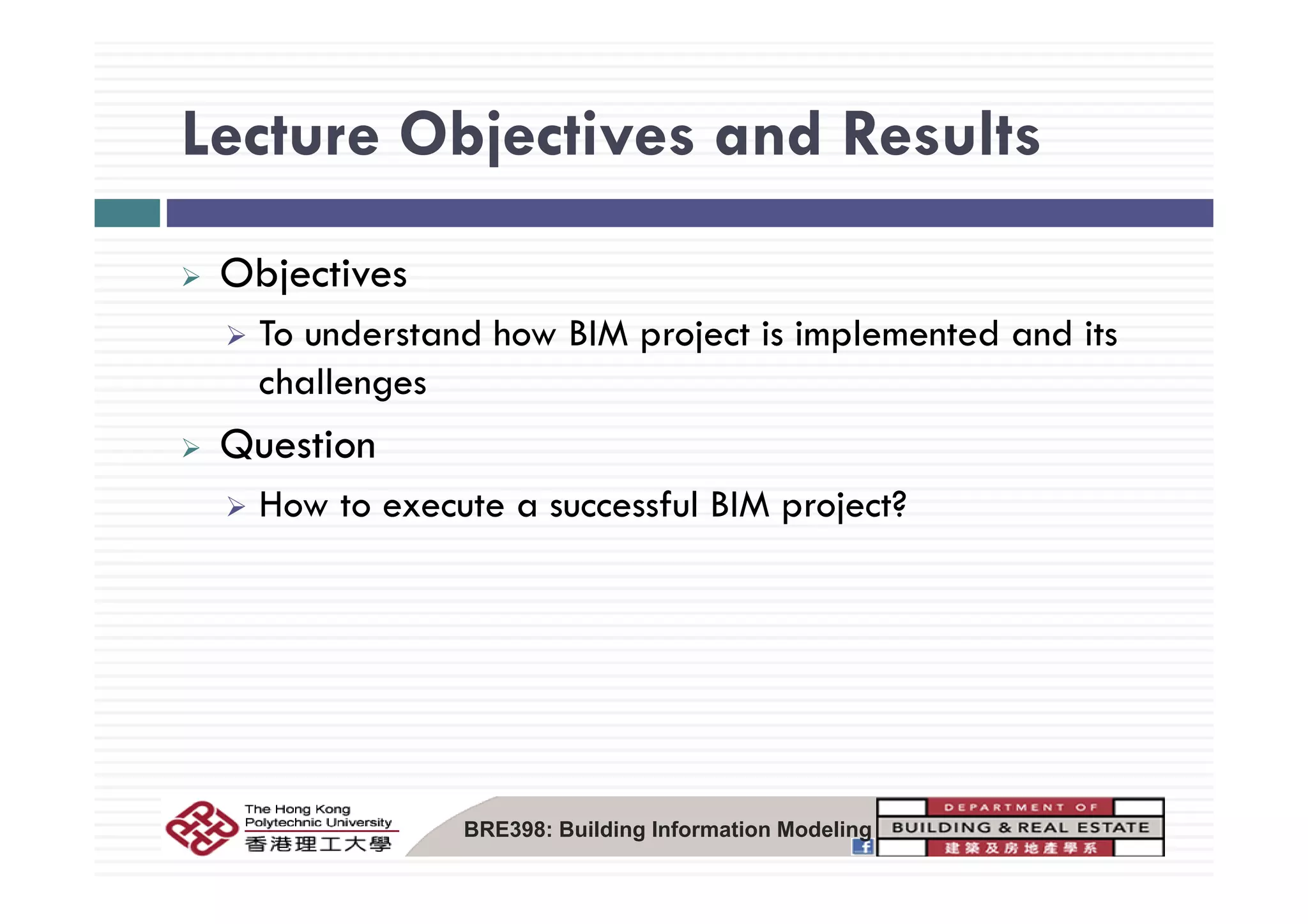

Lecture Objectives and ResultsLecture Objectives and Results
Objectives
To understand how BIM project is implemented and its
challenges
Question
How to execute a successful BIM project?
BRE398: Building Information Modeling

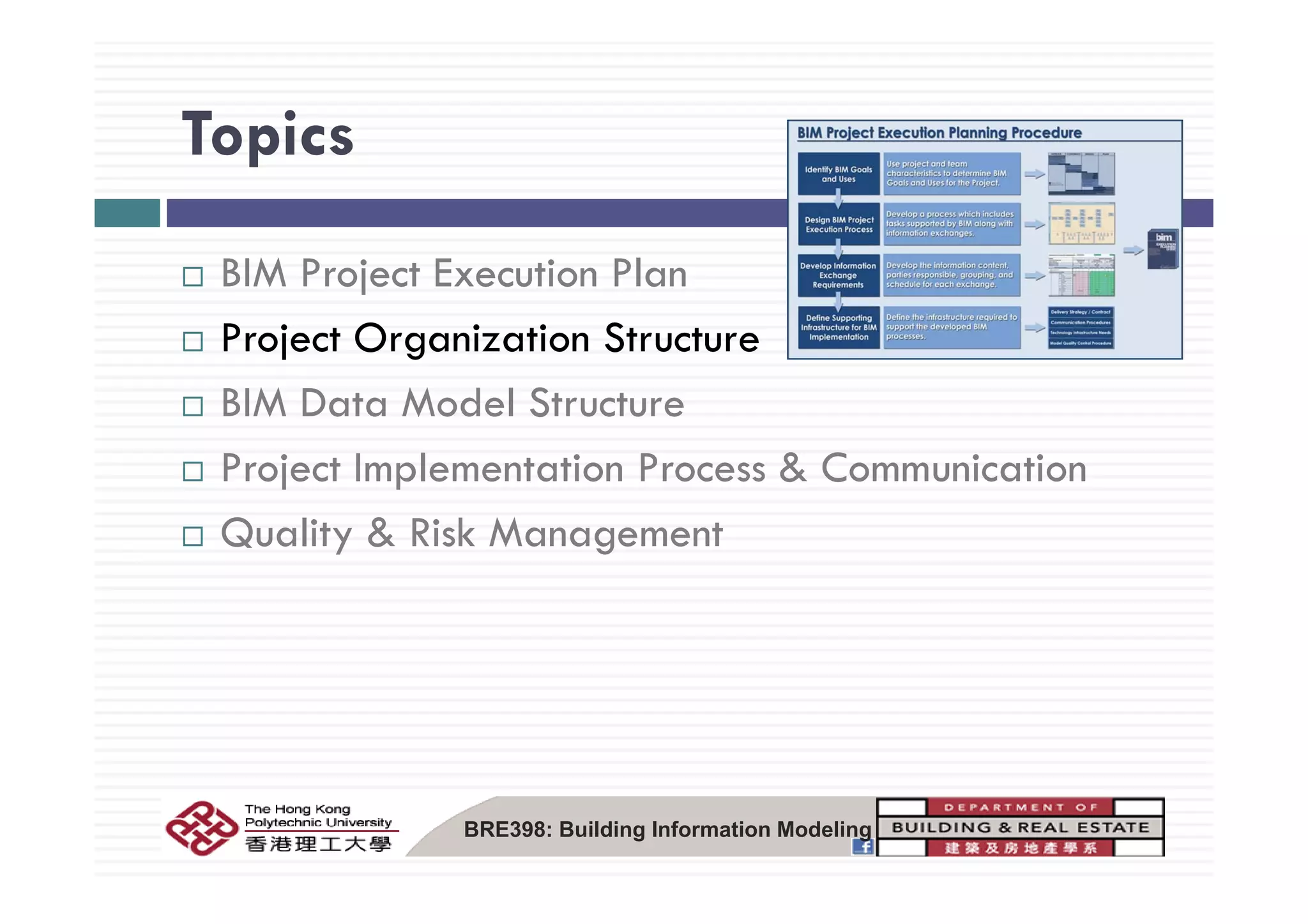

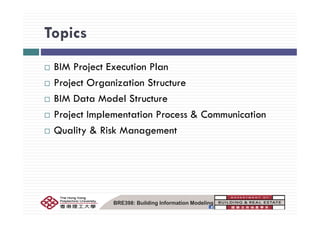

TopicsTopics
BIM Project Execution Plan
Project Organization Structurej g
BIM Data Model Structure
P j t I l t ti P & C i tiProject Implementation Process & Communication
Quality & Risk Management
BRE398: Building Information Modeling

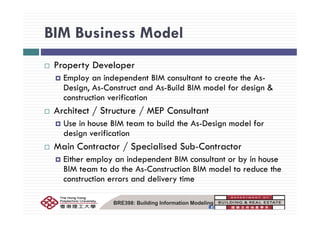

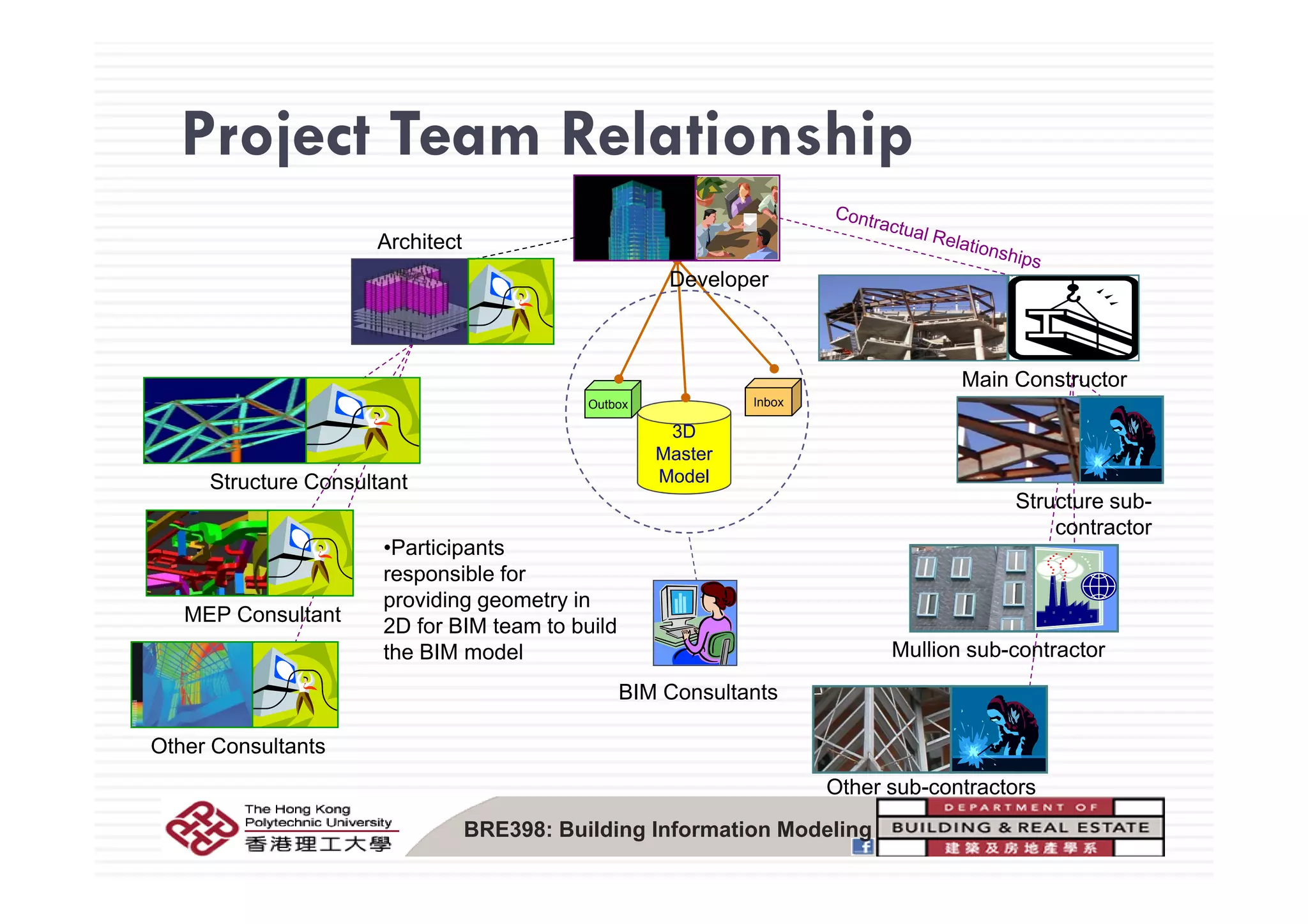

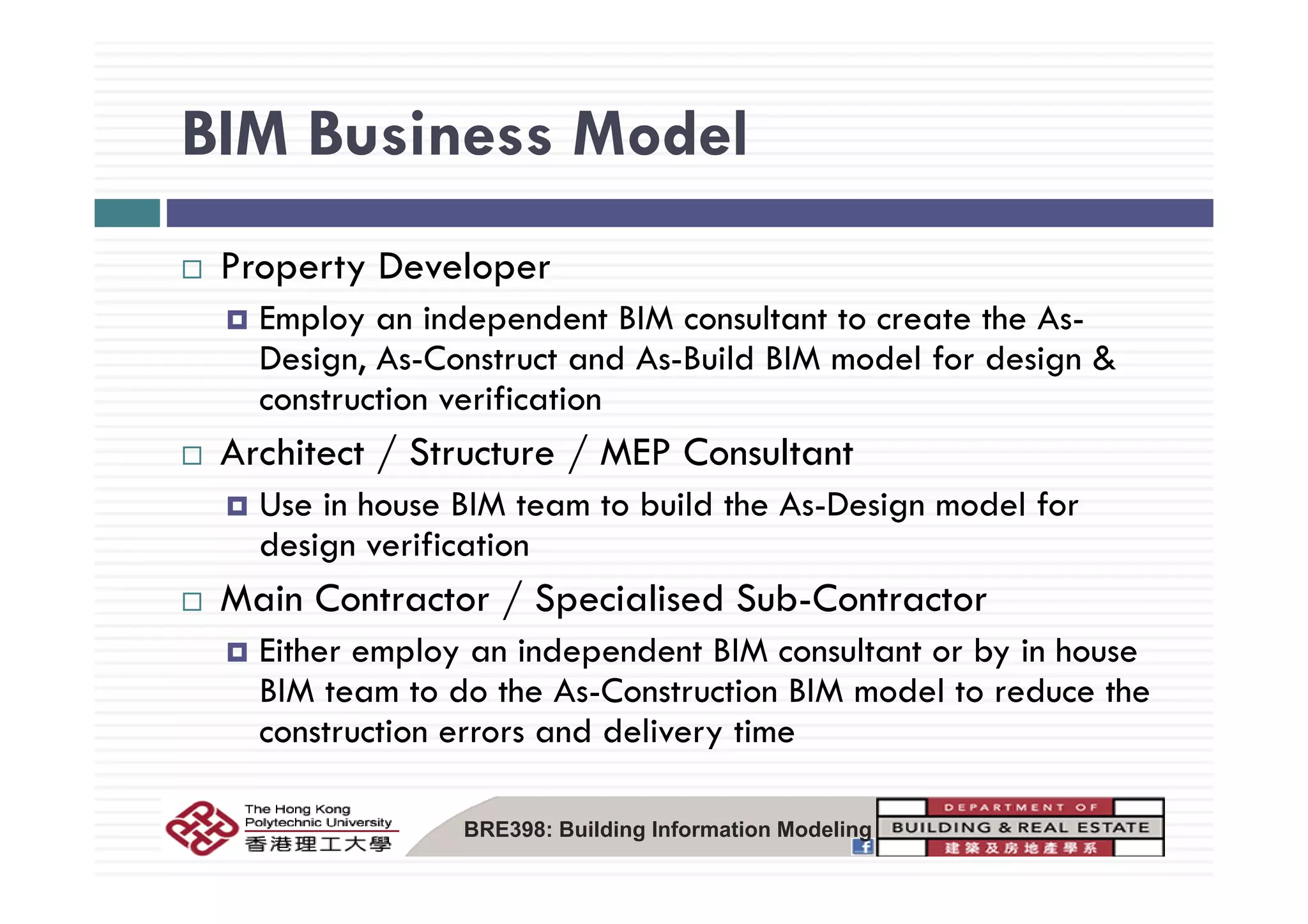

BIM Business ModelBIM Business Model
lProperty Developer
Employ an independent BIM consultant to create the As-
Design As Construct and As Build BIM model for design &Design, As-Construct and As-Build BIM model for design &
construction verification
Architect / Structure / MEP ConsultantArchitect / Structure / MEP Consultant
Use in house BIM team to build the As-Design model for
design verification
Main Contractor / Specialised Sub-Contractor
Either employ an independent BIM consultant or by in house
BIM team to do the As-Construction BIM model to reduce the
construction errors and delivery time
BRE398: Building Information Modeling

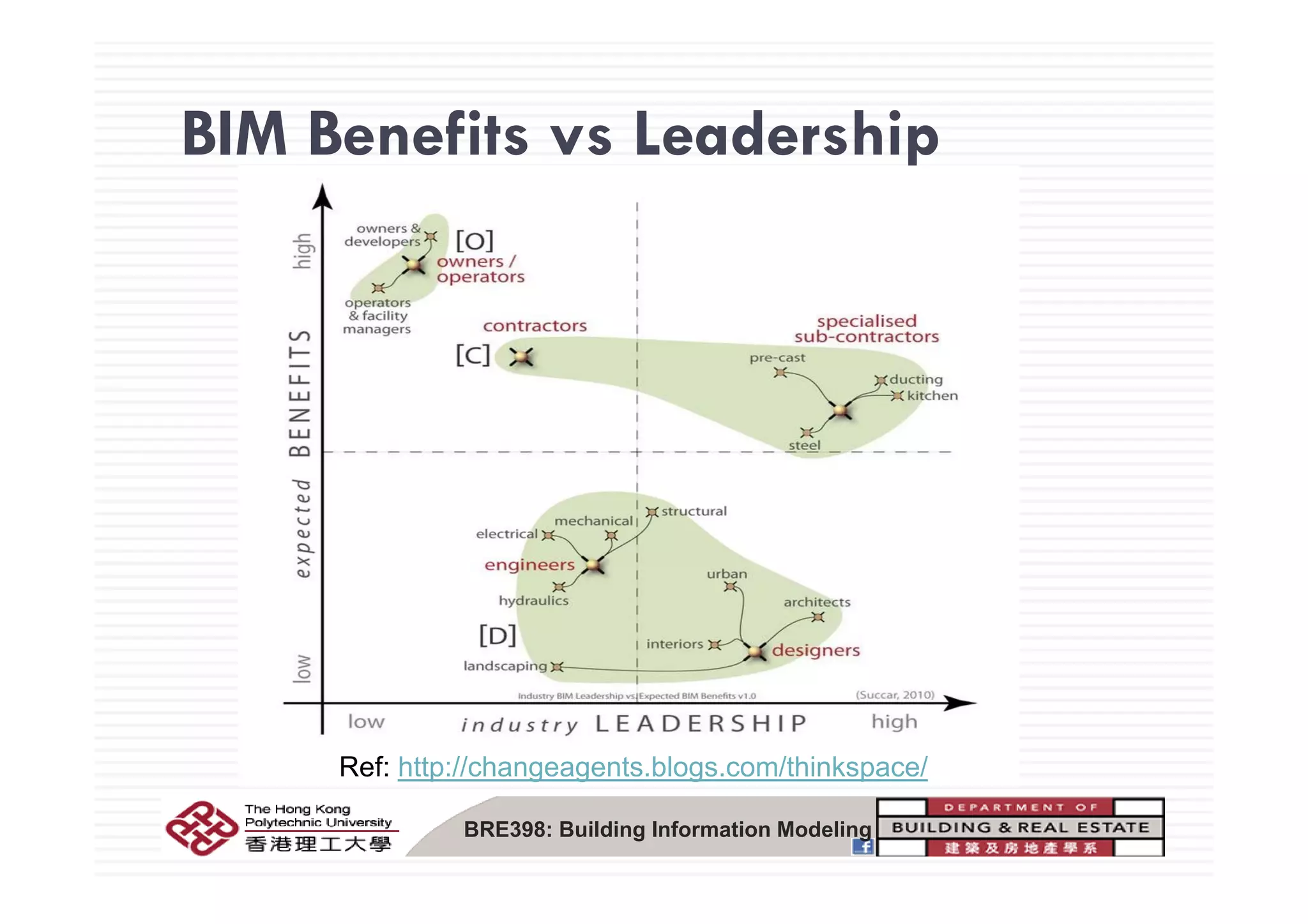

BIM Benefits vs LeadershipBIM Benefits vs Leadership
Ref: http://changeagents.blogs.com/thinkspace/
BRE398: Building Information Modeling
e ttp //c a geage ts b ogs co /t space/

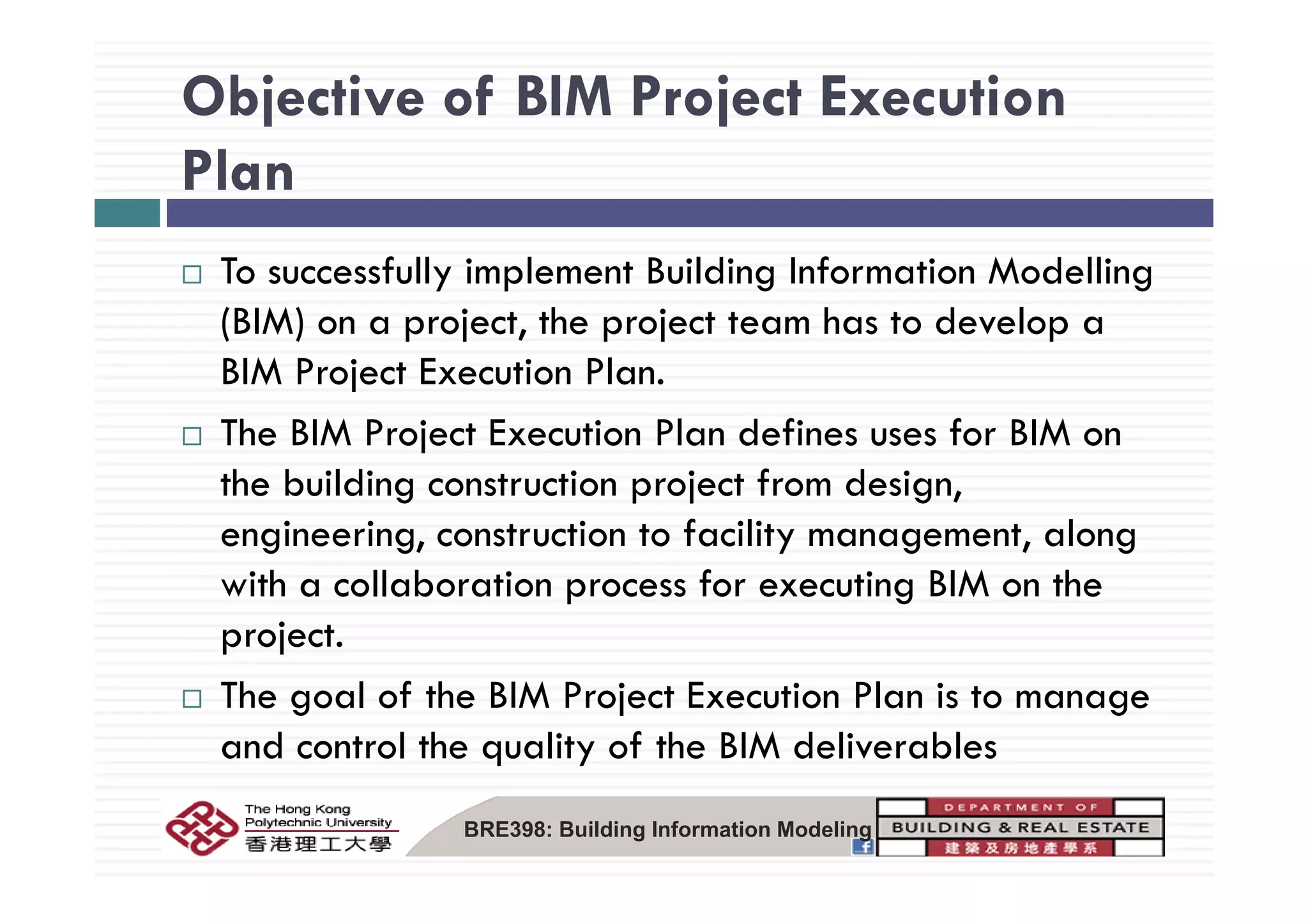

Objective of BIM Project Execution
Plan
To successfully implement Building Information Modelling
(BIM) on a project, the project team has to develop a
MBIM Project Execution Plan.
The BIM Project Execution Plan defines uses for BIM on
the building construction project from design,
engineering, construction to facility management, along
with a collaboration process for executing BIM on the
project.
The goal of the BIM Project Execution Plan is to manage
and control the quality of the BIM deliverables
BRE398: Building Information Modeling

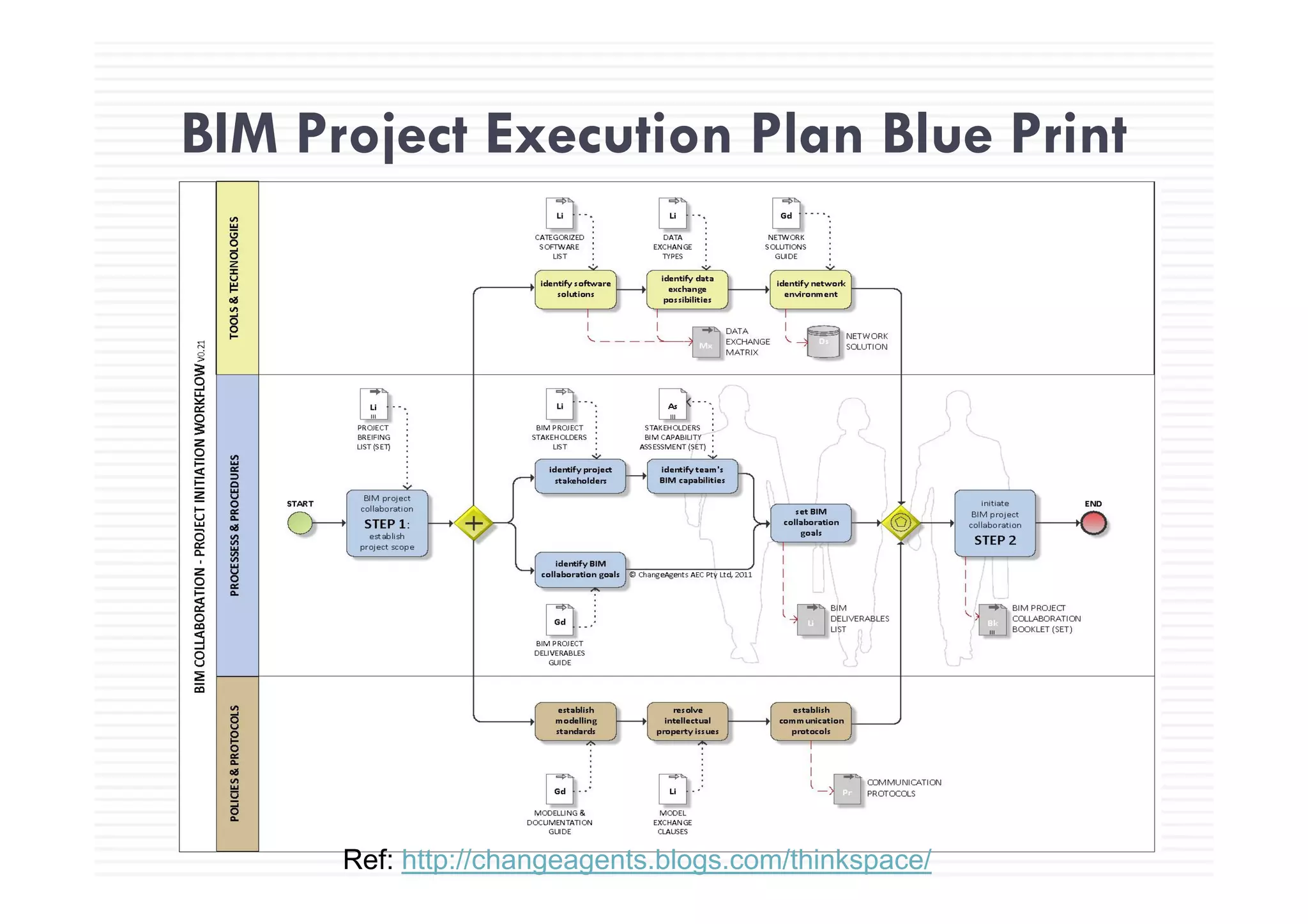

BIM Project Execution Plan Blue PrintBIM Project Execution Plan Blue Print
Ref: http://changeagents.blogs.com/thinkspace/

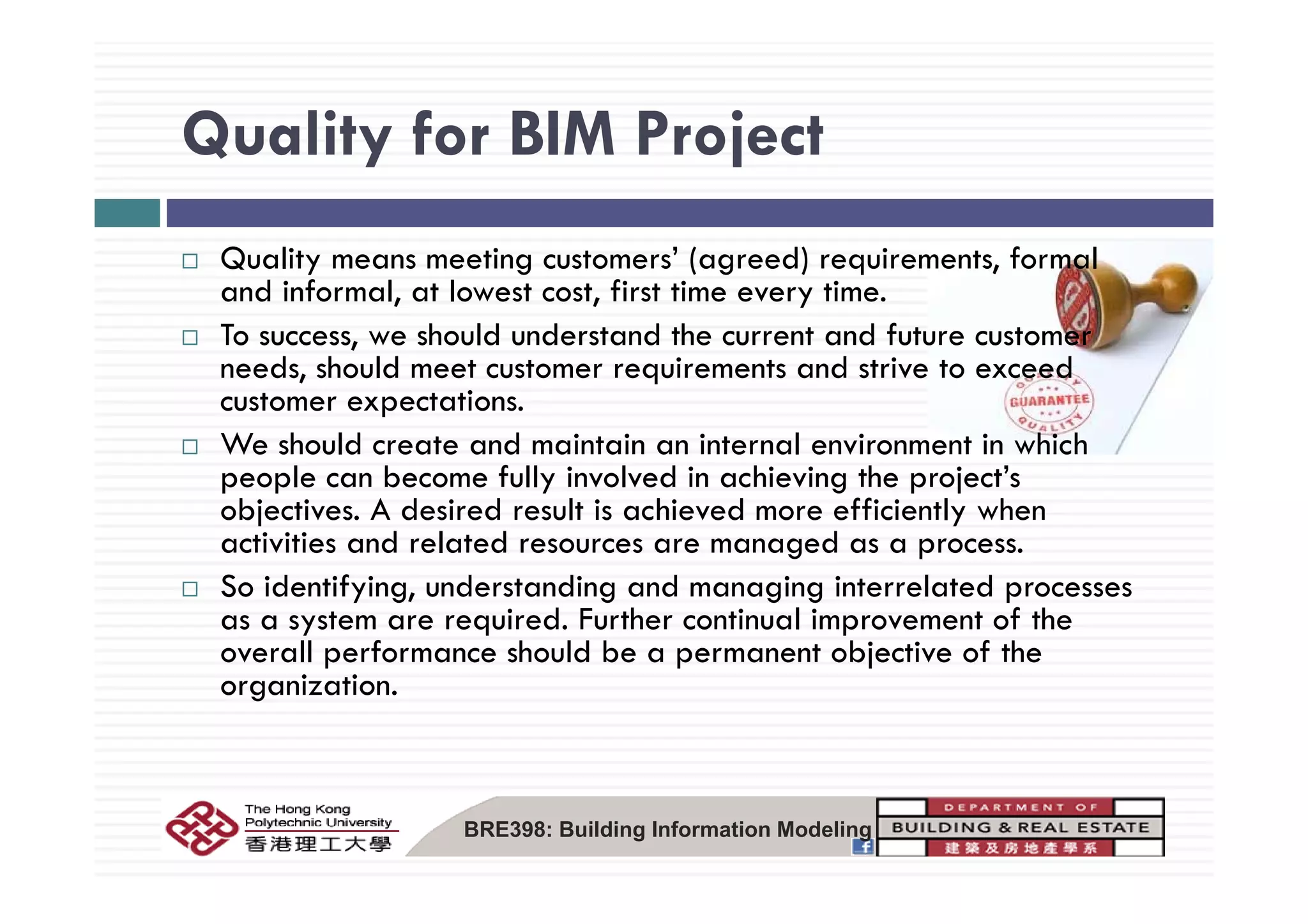

Quality for BIM ProjectQuality for BIM Project
Q lit ti t ’ ( d) i t f lQuality means meeting customers’ (agreed) requirements, formal
and informal, at lowest cost, first time every time.
To success, we should understand the current and future customer
d h ld d dneeds, should meet customer requirements and strive to exceed
customer expectations.
We should create and maintain an internal environment in which
people can become fully involved in achieving the project’s
objectives. A desired result is achieved more efficiently when
activities and related resources are managed as a process.
So identifying, understanding and managing interrelated processes
as a system are required. Further continual improvement of the
overall performance should be a permanent objective of the
organization.
BRE398: Building Information Modeling

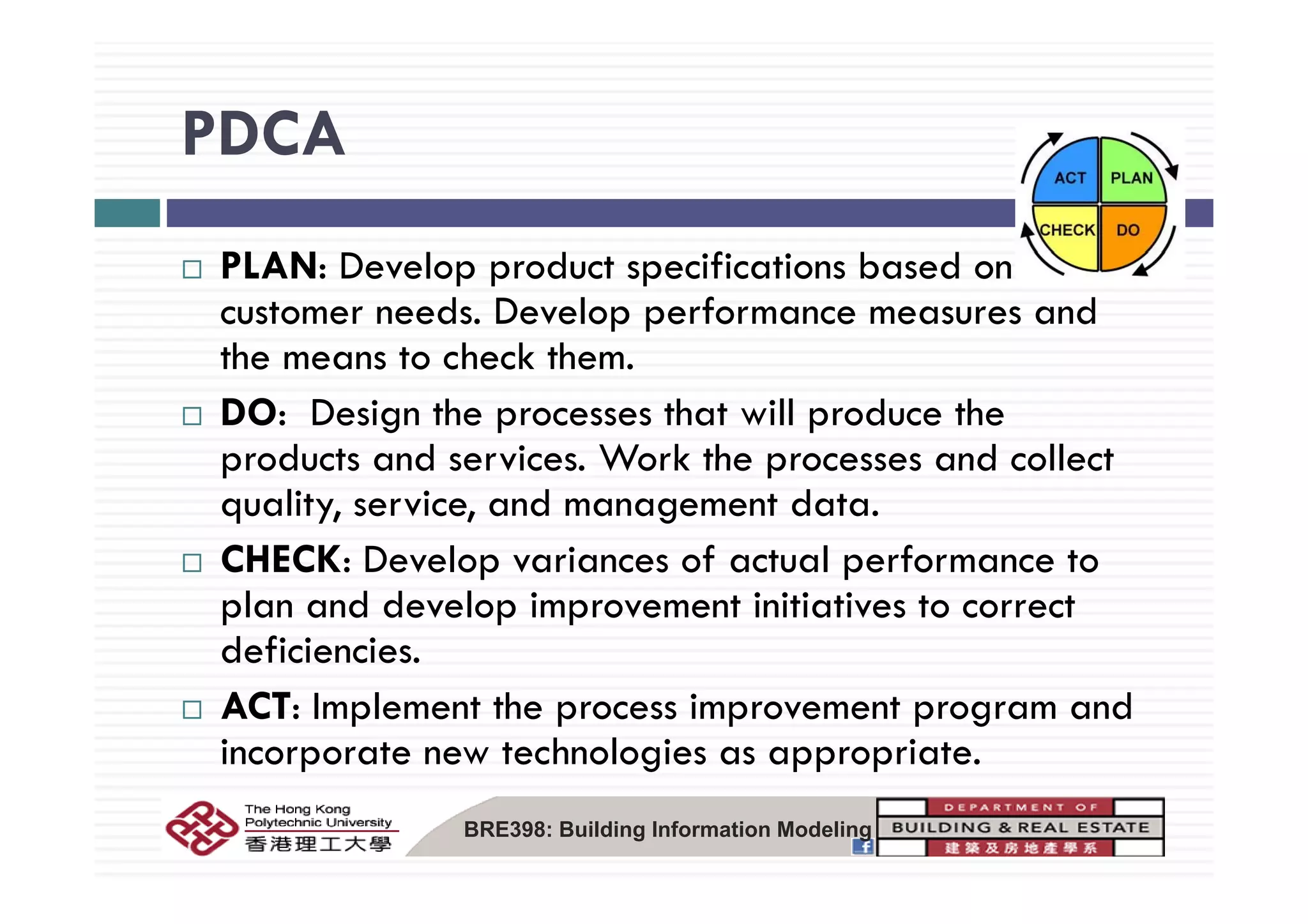

PDCAPDCA
PLAN l d f b dPLAN: Develop product specifications based on
customer needs. Develop performance measures and
the means to check themthe means to check them.
DO: Design the processes that will produce the
products and services Work the processes and collectproducts and services. Work the processes and collect
quality, service, and management data.
CHECK: Develop variances of actual performance toCHECK: Develop variances of actual performance to
plan and develop improvement initiatives to correct
deficiencies.
ACT: Implement the process improvement program and
incorporate new technologies as appropriate.
BRE398: Building Information Modeling

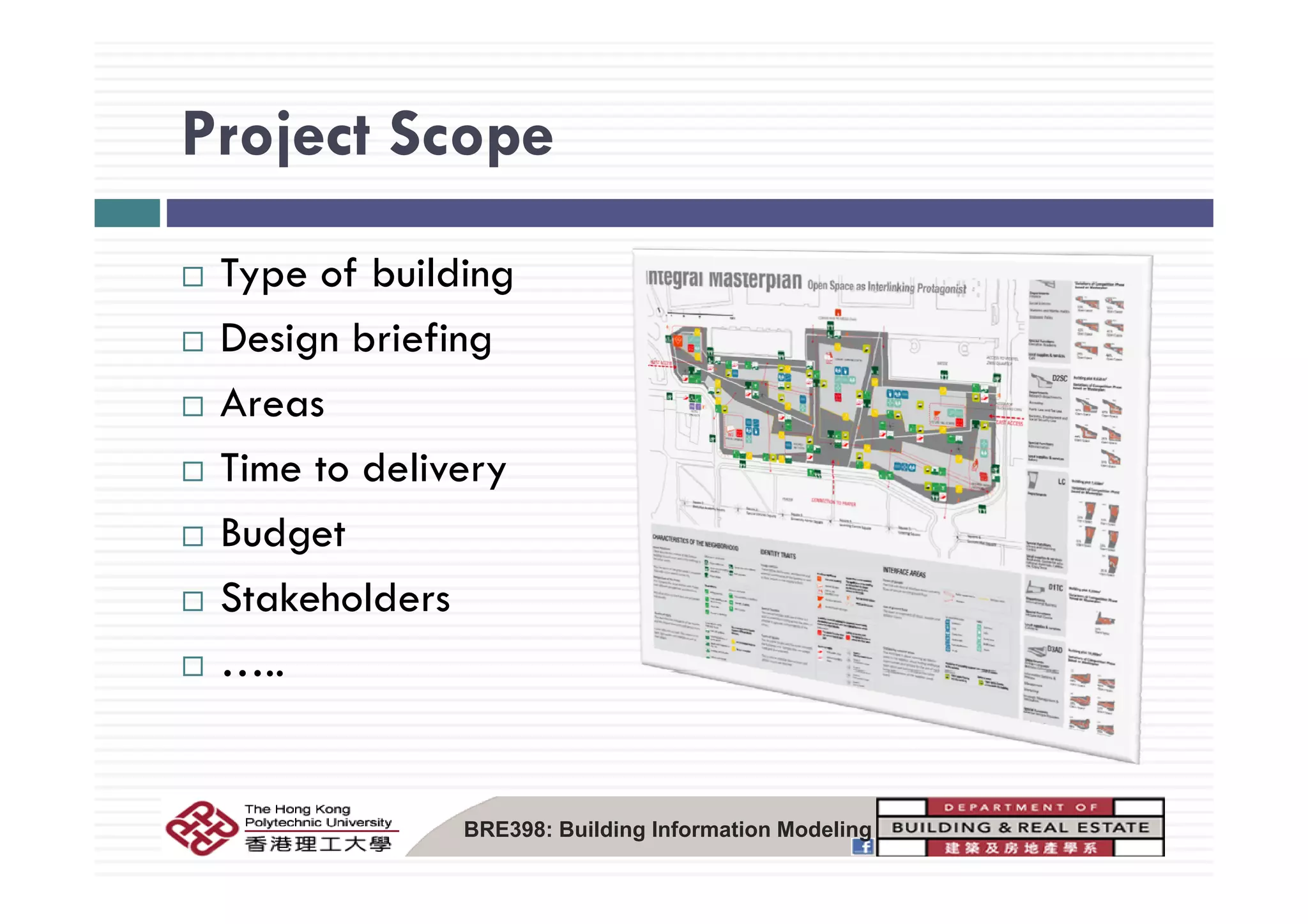

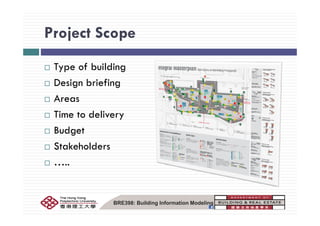

Project ScopeProject Scope
Type of building
Design briefingg g
Areas
Ti t d liTime to delivery
Budget
Stakeholders
…..…..
BRE398: Building Information Modeling

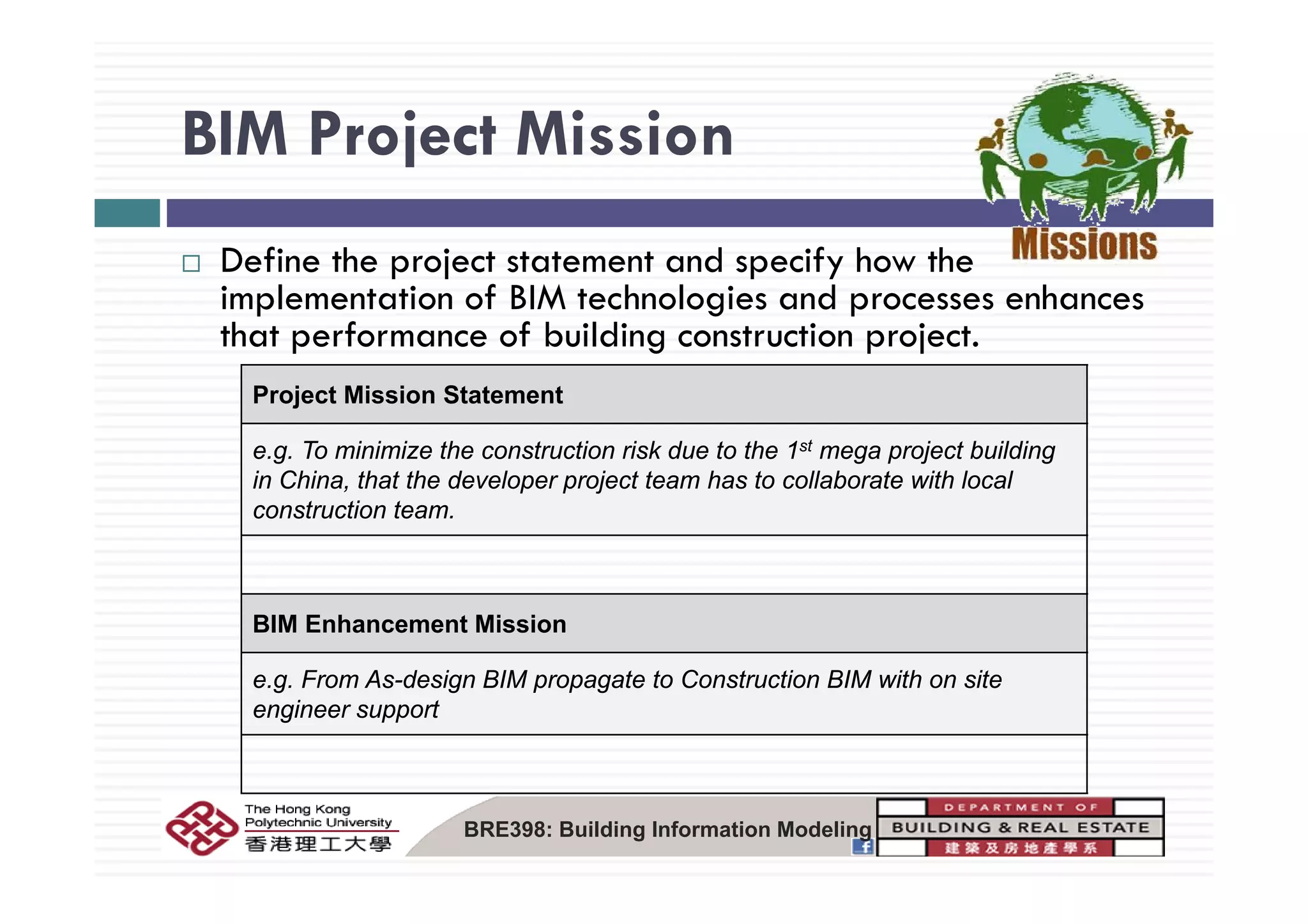

BIM Project MissionBIM Project Mission
D fi th j t t t t d if h thDefine the project statement and specify how the
implementation of BIM technologies and processes enhances
that performance of building construction project.
Project Mission Statement
e.g. To minimize the construction risk due to the 1st mega project buildingg g p j g
in China, that the developer project team has to collaborate with local
construction team.
BIM Enhancement Mission
F A d i BIM t t C t ti BIM ith ite.g. From As-design BIM propagate to Construction BIM with on site
engineer support
BRE398: Building Information Modeling

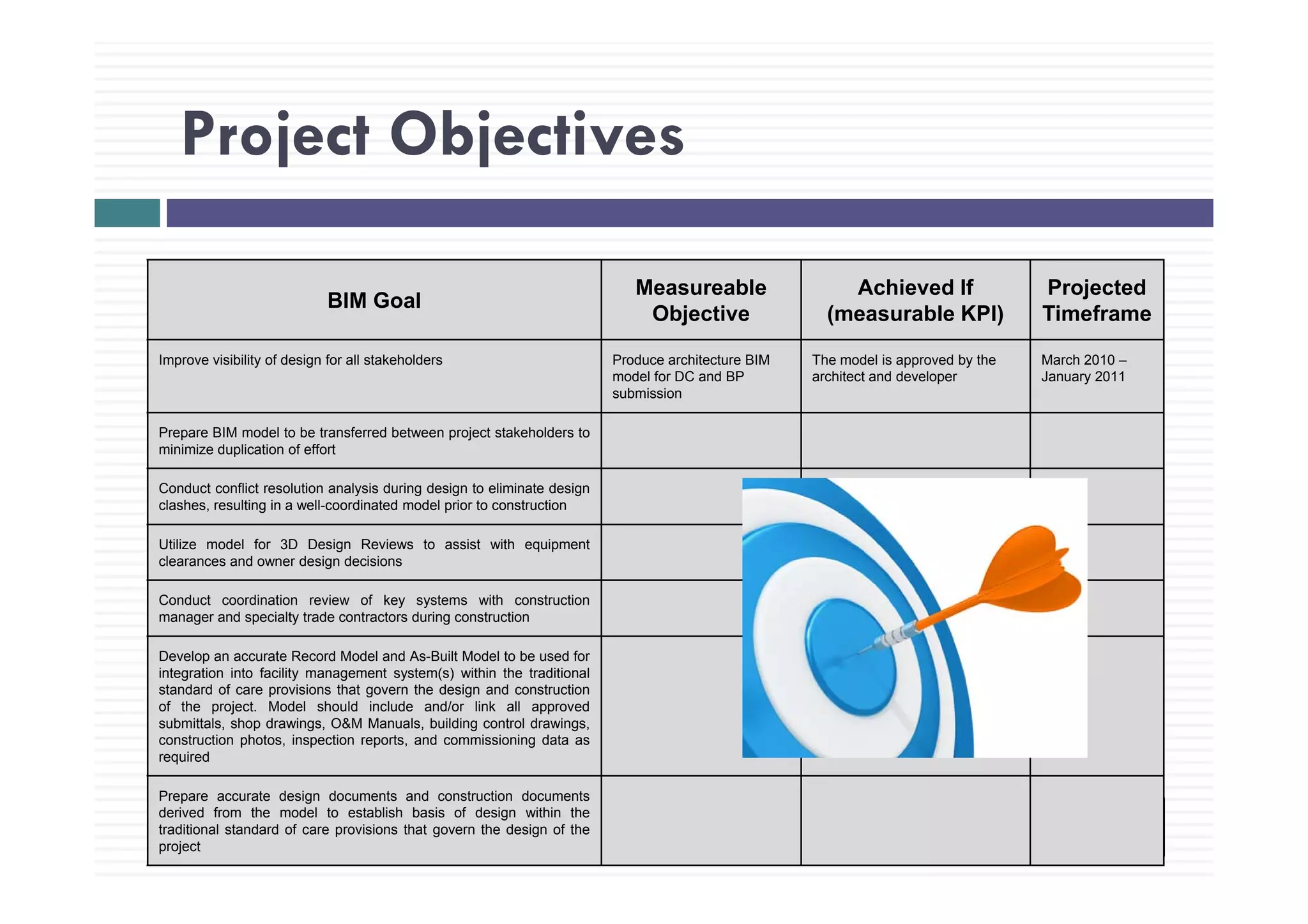

Project ObjectivesProject Objectives
BIM Goal
Measureable
Objective
Achieved If
(measurable KPI)
Projected
Timeframe
I i ibilit f d i f ll t k h ld P d hit t BIM Th d l i d b th M h 2010Improve visibility of design for all stakeholders Produce architecture BIM
model for DC and BP
submission
The model is approved by the
architect and developer
March 2010 –
January 2011
Prepare BIM model to be transferred between project stakeholders to
minimize duplication of effort
Conduct conflict resolution analysis during design to eliminate design
clashes, resulting in a well-coordinated model prior to construction
Utilize model for 3D Design Reviews to assist with equipment
clearances and owner design decisionsg
Conduct coordination review of key systems with construction
manager and specialty trade contractors during construction
Develop an accurate Record Model and As-Built Model to be used for
integration into facility management system(s) within the traditionalintegration into facility management system(s) within the traditional
standard of care provisions that govern the design and construction
of the project. Model should include and/or link all approved
submittals, shop drawings, O&M Manuals, building control drawings,
construction photos, inspection reports, and commissioning data as
required
BRE398: Building Information Modeling
Prepare accurate design documents and construction documents
derived from the model to establish basis of design within the
traditional standard of care provisions that govern the design of the
project

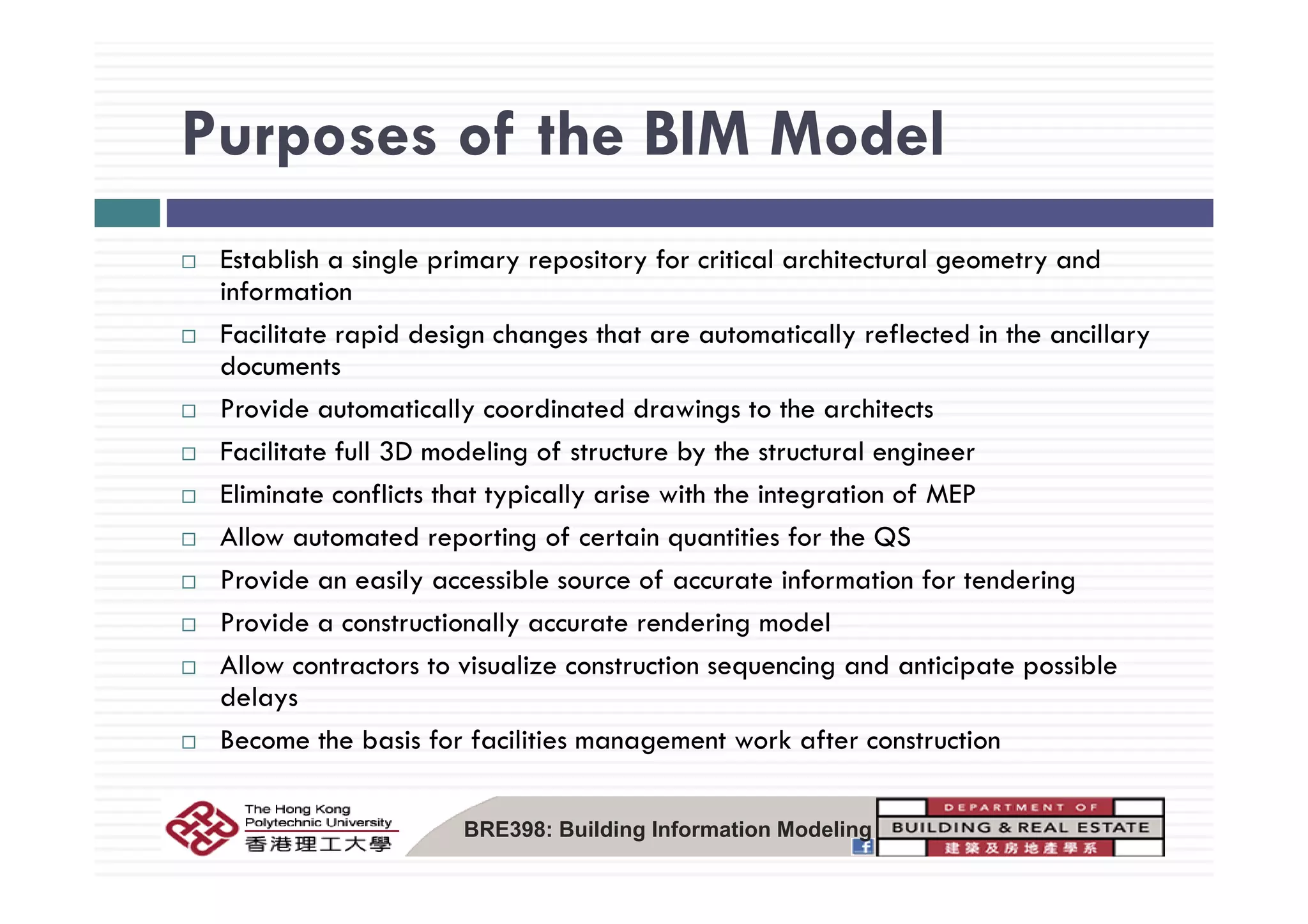

Purposes of the BIM ModelPurposes of the BIM Model
E bli h i l i i f i i l hi l dEstablish a single primary repository for critical architectural geometry and
information
Facilitate rapid design changes that are automatically reflected in the ancillary
ddocuments
Provide automatically coordinated drawings to the architects
Facilitate full 3D modeling of structure by the structural engineerg y g
Eliminate conflicts that typically arise with the integration of MEP
Allow automated reporting of certain quantities for the QS
Provide an easily accessible source of accurate information for tendering
Provide a constructionally accurate rendering model
Allow contractors to visualize construction sequencing and anticipate possibleAllow contractors to visualize construction sequencing and anticipate possible
delays
Become the basis for facilities management work after construction
BRE398: Building Information Modeling

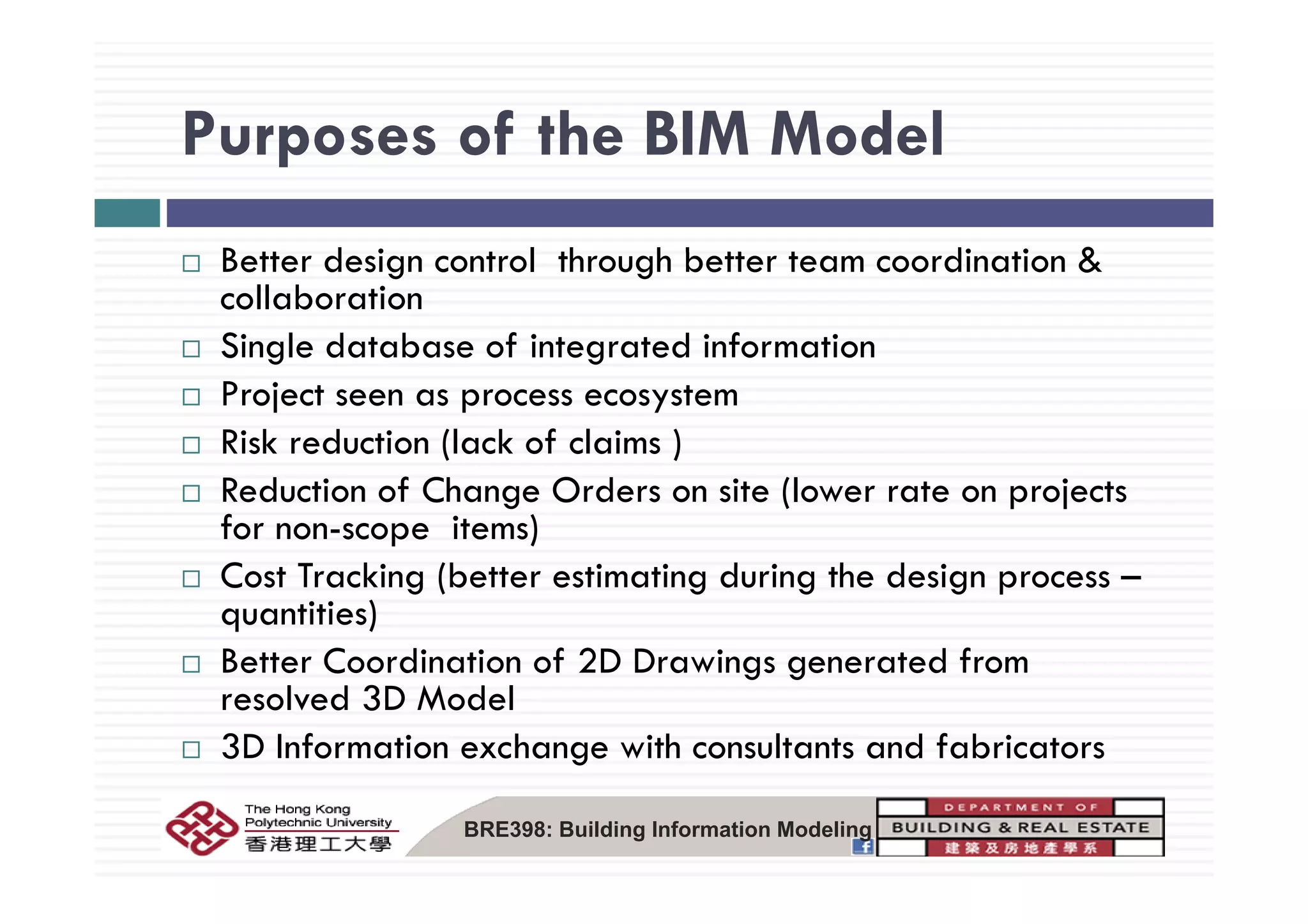

Purposes of the BIM ModelPurposes of the BIM Model
B tt d i t l th h b tt t di ti &Better design control through better team coordination &
collaboration
Single database of integrated informationSingle database of integrated information
Project seen as process ecosystem
Risk reduction (lack of claims )
Reduction of Change Orders on site (lower rate on projects
for non-scope items)
C T ki (b i i d i h d iCost Tracking (better estimating during the design process –
quantities)
Better Coordination of 2D Drawings generated fromBetter Coordination of 2D Drawings generated from
resolved 3D Model
3D Information exchange with consultants and fabricators
BRE398: Building Information Modeling

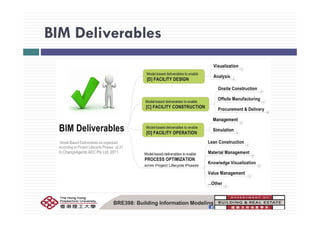

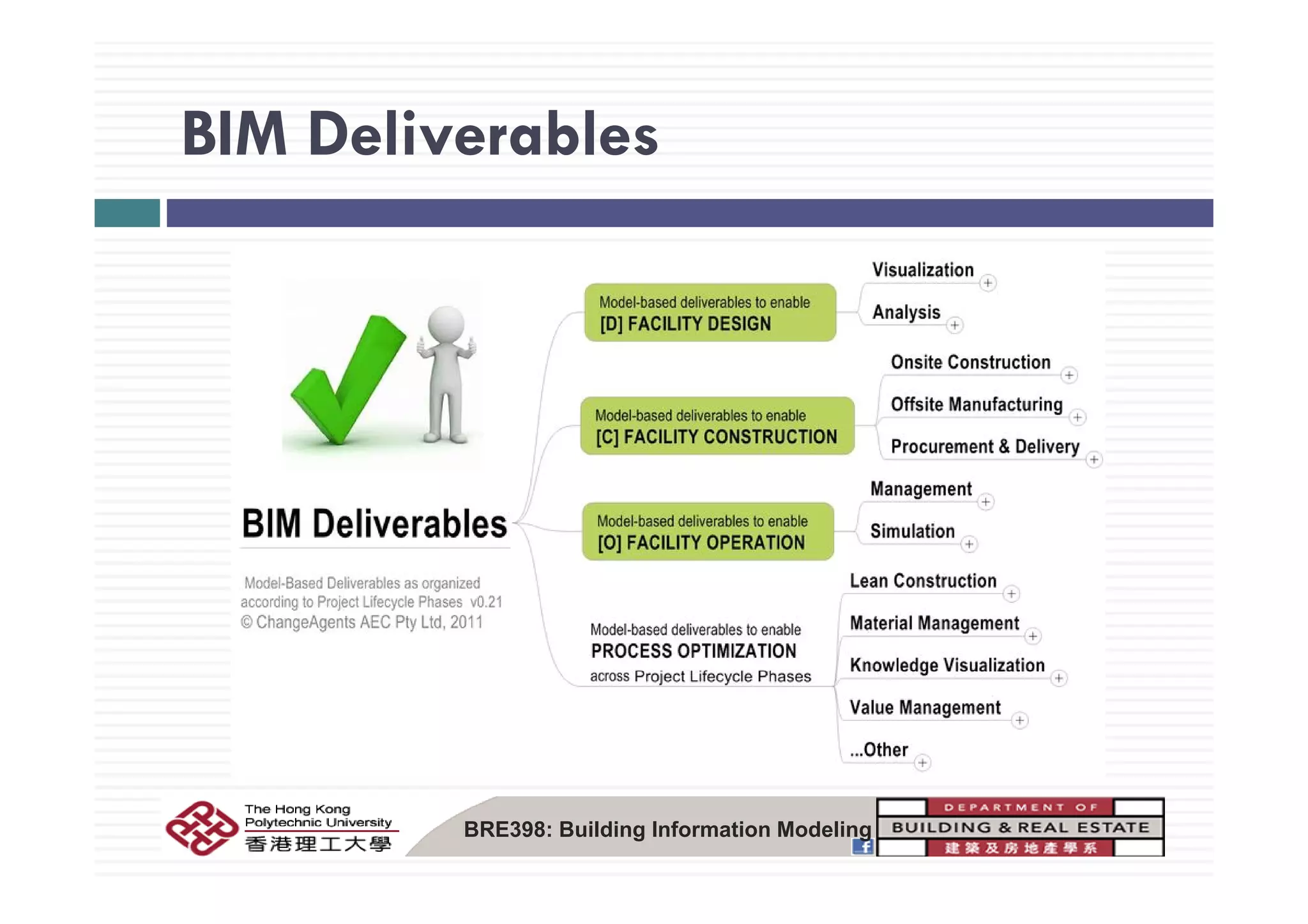

BIM DeliverablesBIM Deliverables
BRE398: Building Information Modeling

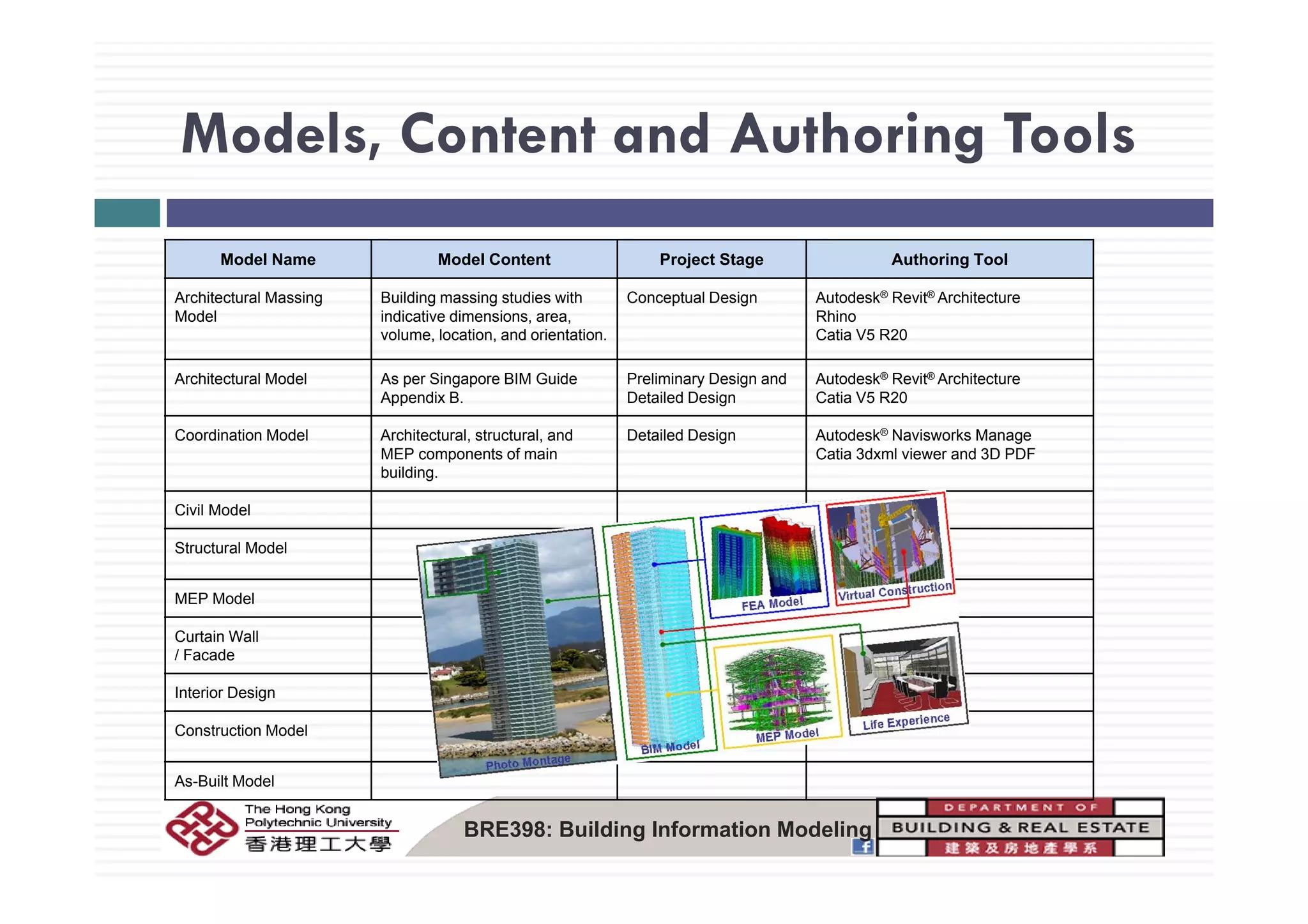

Models, Content and Authoring ToolsModels, Content and Authoring Tools
Model Name Model Content Project Stage Authoring Tool
Architectural Massing
Model
Building massing studies with
indicative dimensions, area,
volume, location, and orientation.
Conceptual Design Autodesk® Revit® Architecture
Rhino
Catia V5 R20
Architectural Model As per Singapore BIM Guide
Appendix B.
Preliminary Design and
Detailed Design
Autodesk® Revit® Architecture
Catia V5 R20
Coordination Model Architectural, structural, and
MEP components of main
Detailed Design Autodesk® Navisworks Manage
Catia 3dxml viewer and 3D PDFp
building.
Civil Model
Structural Model
MEP Model
Curtain Wall
/ Facade
Interior Design
Construction Model
A B ilt M d l
BRE398: Building Information Modeling
As-Built Model

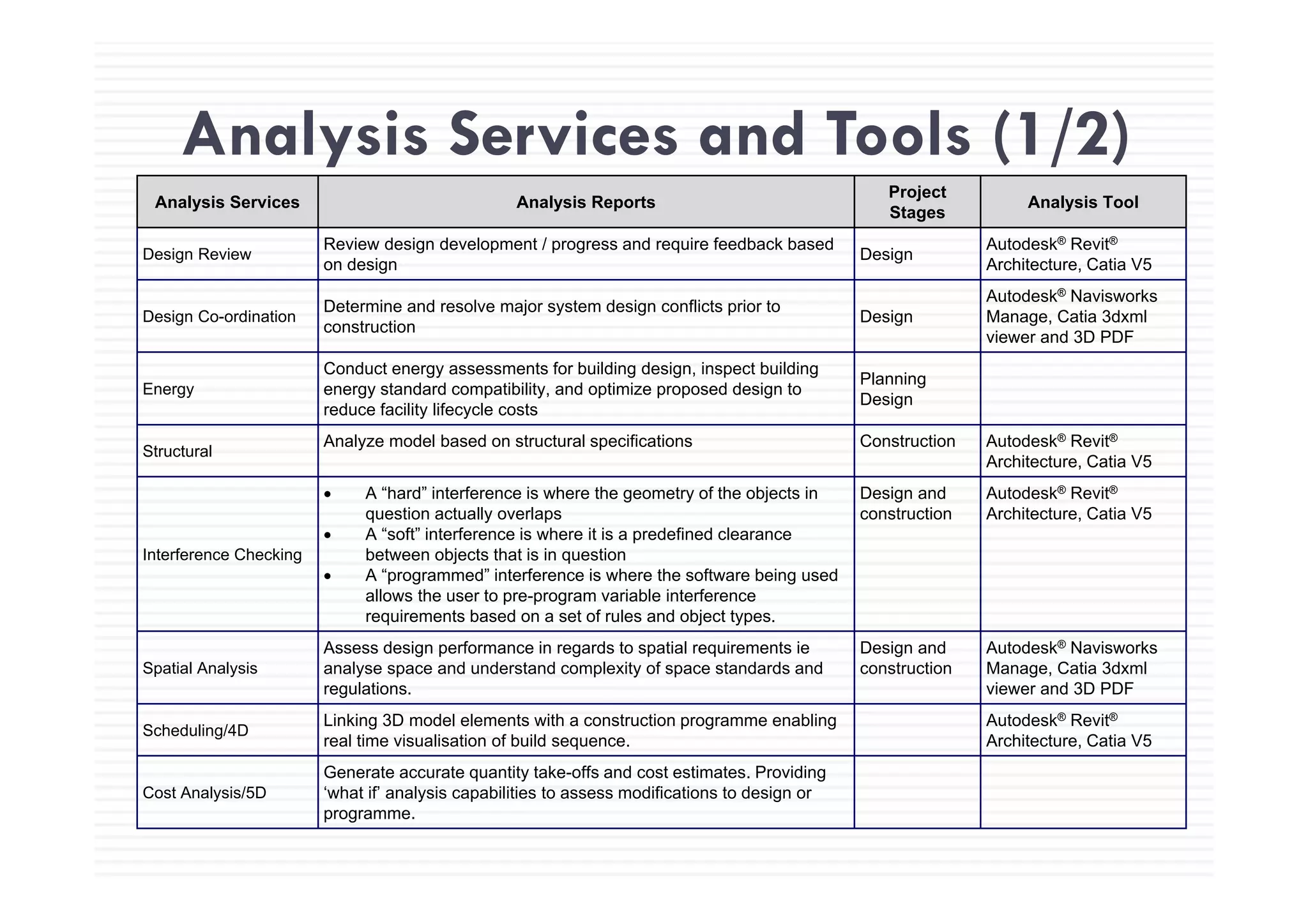

Analysis Services and Tools (1/2)Analysis Services and Tools (1/2)
Analysis Services Analysis Reports
Project
Stages
Analysis Tool
Design Review
Review design development / progress and require feedback based
Design
Autodesk® Revit®
Design Review
g p p g q
on design
Design
Architecture, Catia V5
Design Co-ordination
Determine and resolve major system design conflicts prior to
construction
Design
Autodesk® Navisworks
Manage, Catia 3dxml
viewer and 3D PDF
Energy
Conduct energy assessments for building design, inspect building
energy standard compatibility, and optimize proposed design to
reduce facility lifecycle costs
Planning
Design
Structural
Analyze model based on structural specifications Construction Autodesk® Revit®
Architecture Catia V5Architecture, Catia V5
Interference Checking
• A “hard” interference is where the geometry of the objects in
question actually overlaps
• A “soft” interference is where it is a predefined clearance
between objects that is in question
Design and
construction
Autodesk® Revit®
Architecture, Catia V5
• A “programmed” interference is where the software being used
allows the user to pre-program variable interference
requirements based on a set of rules and object types.
Spatial Analysis
Assess design performance in regards to spatial requirements ie
analyse space and understand complexity of space standards and
Design and
construction
Autodesk® Navisworks
Manage Catia 3dxmlSpatial Analysis analyse space and understand complexity of space standards and
regulations.
construction Manage, Catia 3dxml
viewer and 3D PDF
Scheduling/4D
Linking 3D model elements with a construction programme enabling
real time visualisation of build sequence.
Autodesk® Revit®
Architecture, Catia V5
Generate accurate quantity take-offs and cost estimates. Providing
Cost Analysis/5D
Generate accurate quantity take offs and cost estimates. Providing
‘what if’ analysis capabilities to assess modifications to design or
programme.

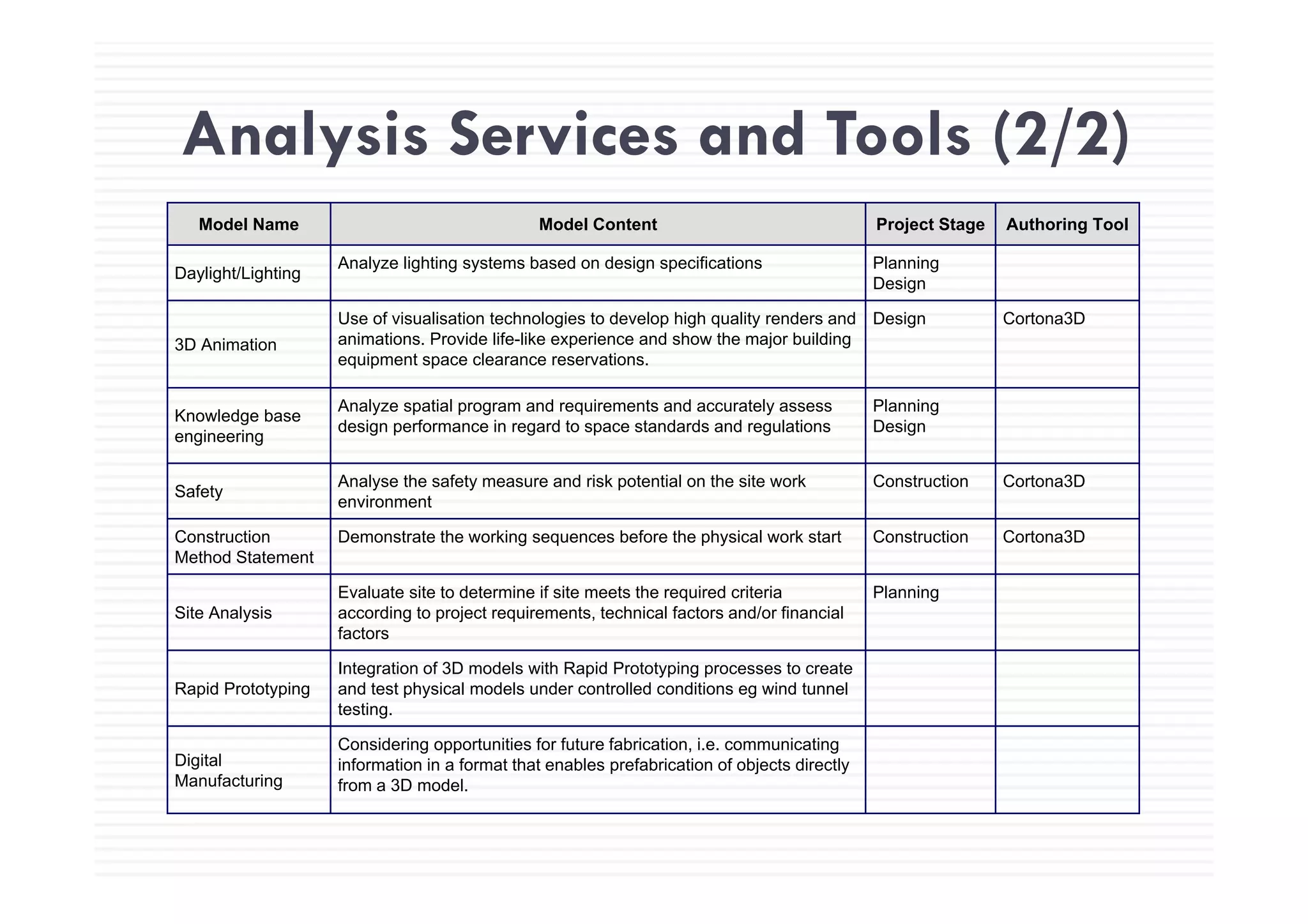

Analysis Services and Tools (2/2)Analysis Services and Tools (2/2)
Model Name Model Content Project Stage Authoring Tool
Daylight/Lighting
Analyze lighting systems based on design specifications Planning
Design
3D Animation
Use of visualisation technologies to develop high quality renders and
animations. Provide life-like experience and show the major building
equipment space clearance reservations
Design Cortona3D
equipment space clearance reservations.
Knowledge base
engineering
Analyze spatial program and requirements and accurately assess
design performance in regard to space standards and regulations
Planning
Design
Safety
Analyse the safety measure and risk potential on the site work
environment
Construction Cortona3D
Construction
Method Statement
Demonstrate the working sequences before the physical work start Construction Cortona3D
Site Analysis
Evaluate site to determine if site meets the required criteria
according to project requirements, technical factors and/or financial
factors
Planning
Integration of 3D models with Rapid Prototyping processes to create
Rapid Prototyping
Integration of 3D models with Rapid Prototyping processes to create
and test physical models under controlled conditions eg wind tunnel
testing.
Digital
M f t i
Considering opportunities for future fabrication, i.e. communicating
information in a format that enables prefabrication of objects directly
Manufacturing from a 3D model.

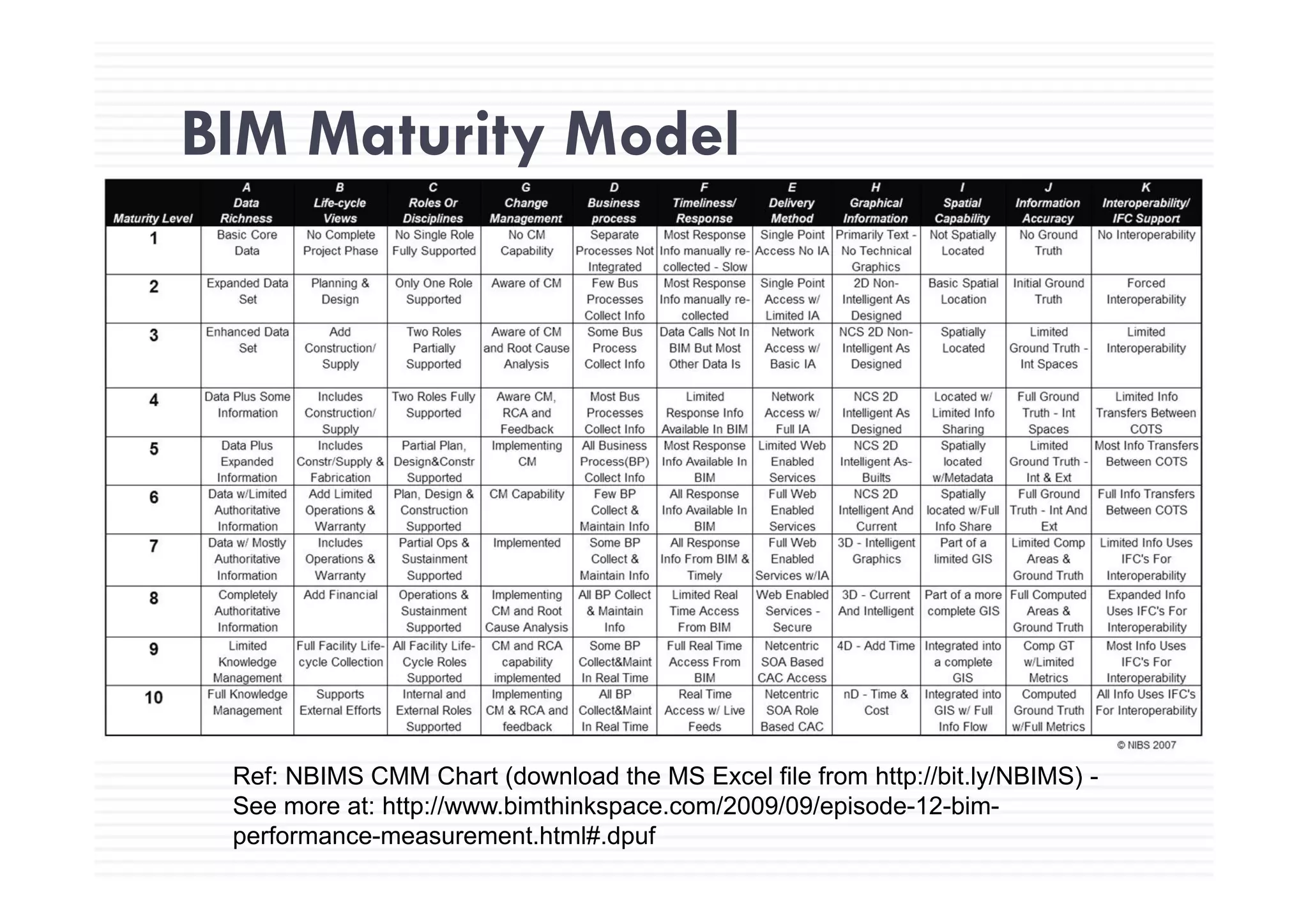

BIM Maturity ModelBIM Maturity Model
Ref: NBIMS CMM Chart (download the MS Excel file from http://bit ly/NBIMS)Ref: NBIMS CMM Chart (download the MS Excel file from http://bit.ly/NBIMS) -
See more at: http://www.bimthinkspace.com/2009/09/episode-12-bim-
performance-measurement.html#.dpuf

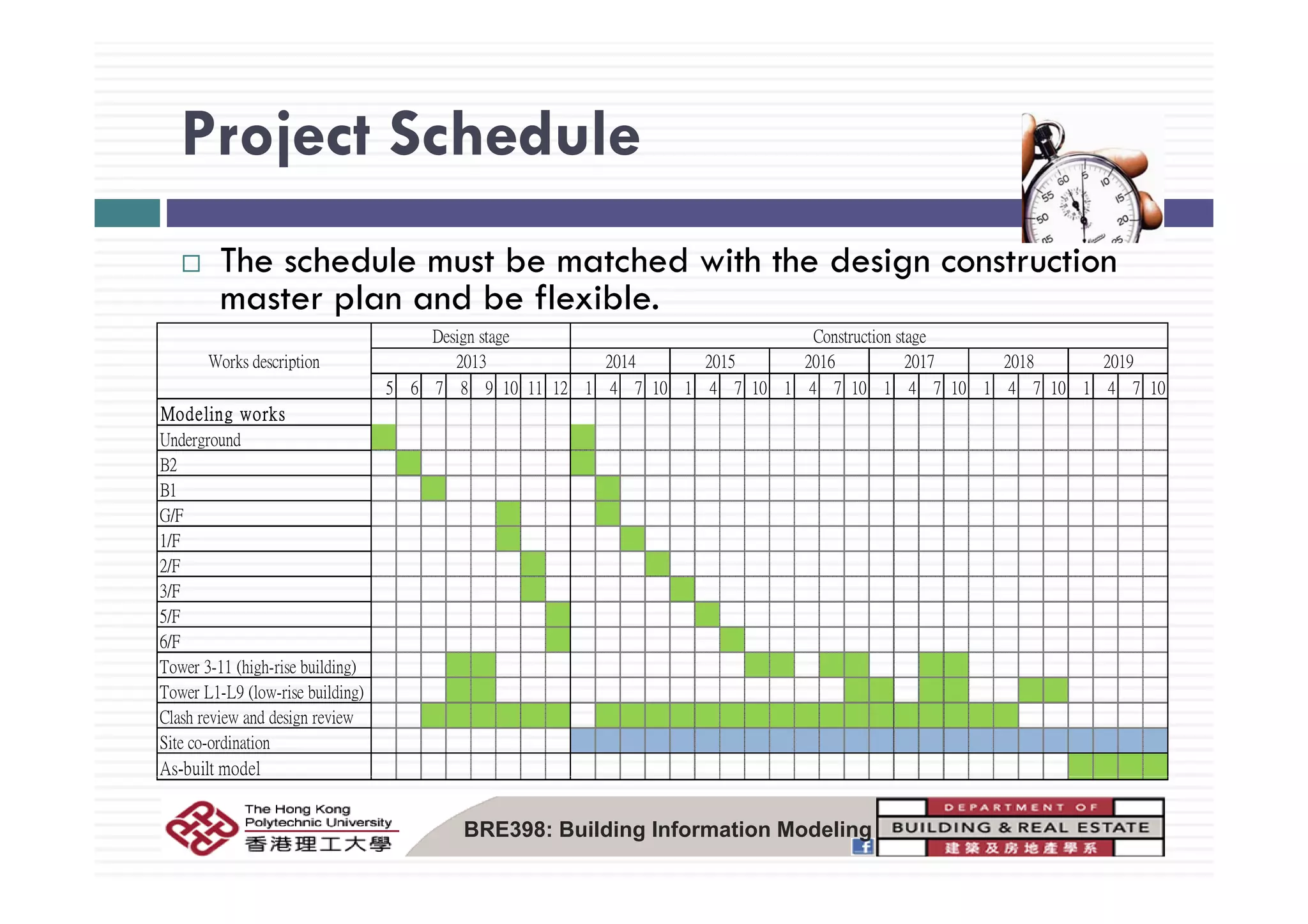

Project ScheduleProject Schedule
Th h d l t b t h d ith th d i t tiThe schedule must be matched with the design construction
master plan and be flexible.
W k d i ti
Design stage Construction stage
2013 2014 2015 2016 2017 2018 2019
5 6 7 8 9 10 11 12 1 4 7 10 1 4 7 10 1 4 7 10 1 4 7 10 1 4 7 10 1 4 7 10
Modeling works
Underground
B2
Works description 2013 2014 2015 2016 2017 2018 2019
B2
B1
G/F
1/F
2/F2/F
3/F
5/F
6/F
Tower 3-11 (high-rise building)Tower 3 11 (high rise building)
Tower L1-L9 (low-rise building)
Clash review and design review
Site co-ordination
As-built model
BRE398: Building Information Modeling

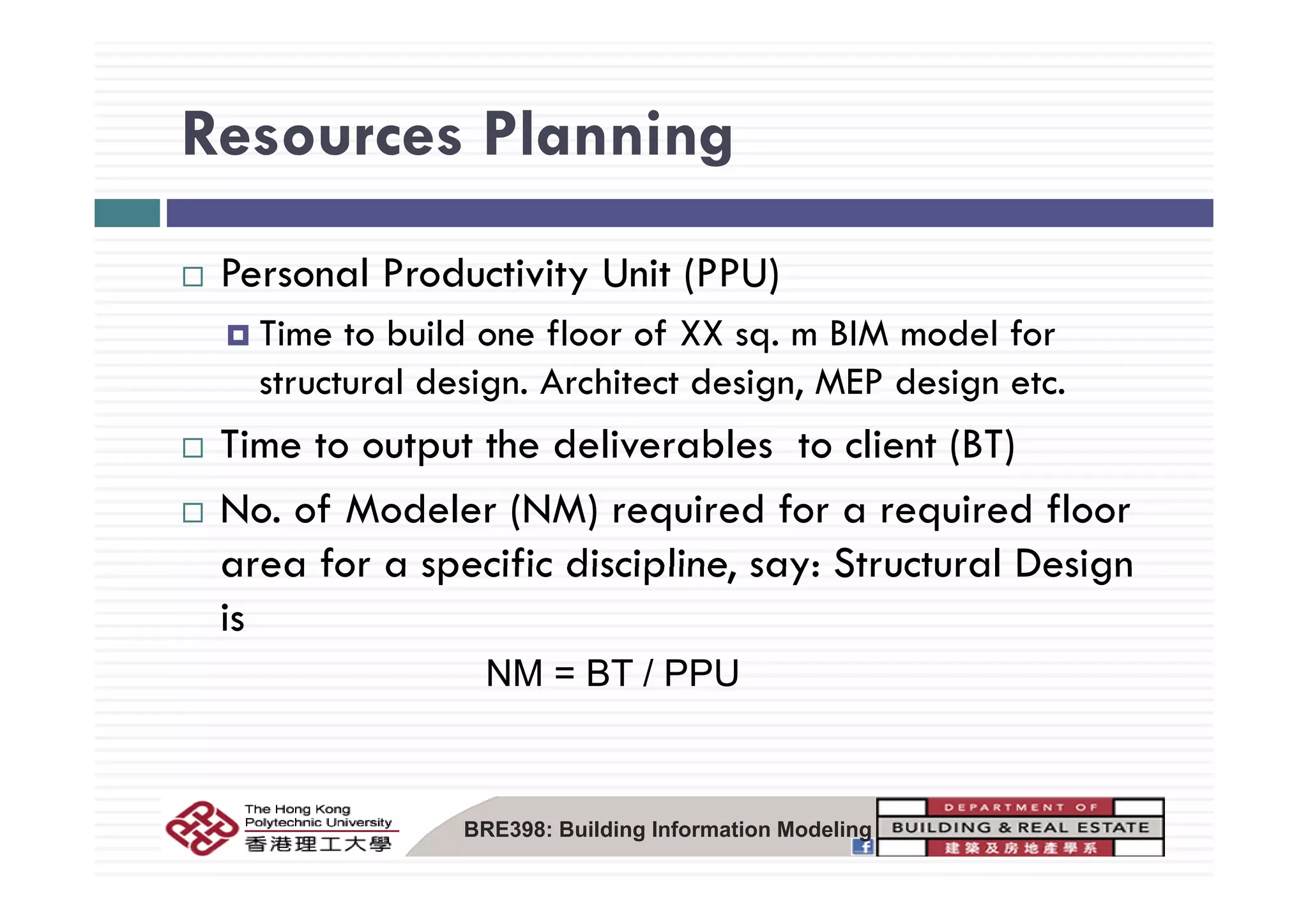

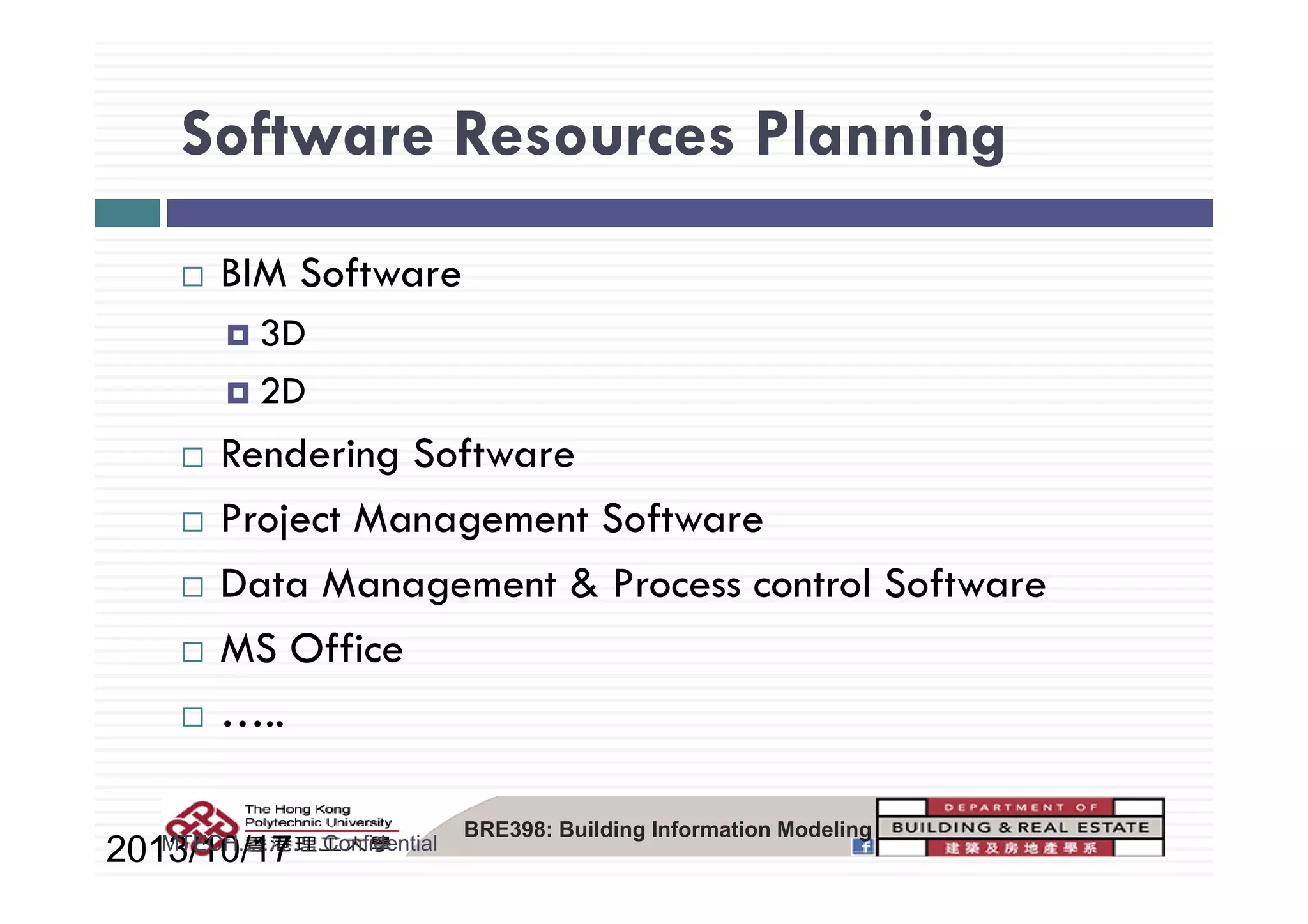

Resources PlanningResources Planning
Personal Productivity Unit (PPU)
Time to build one floor of XX sq. m BIM model for
structural design. Architect design, MEP design etc.
Time to output the deliverables to client (BT)p ( )
No. of Modeler (NM) required for a required floor
area for a specific discipline say: Structural Designarea for a specific discipline, say: Structural Design
is
NM = BT / PPUNM = BT / PPU
BRE398: Building Information Modeling
TopicsTopics
BIM Project Execution Plan
Project Organization Structurej g
BIM Data Model Structure
P j t I l t ti P & C i tiProject Implementation Process & Communication
Quality & Risk Management
BRE398: Building Information Modeling

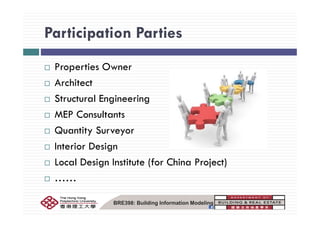

Participation PartiesParticipation Parties
Properties Owner
Architect
Structural Engineering
MEP C lt tMEP Consultants
Quantity Surveyor
Interior Design
Local Design Institute (for China Project)Local Design Institute (for China Project)
……
BRE398: Building Information Modeling

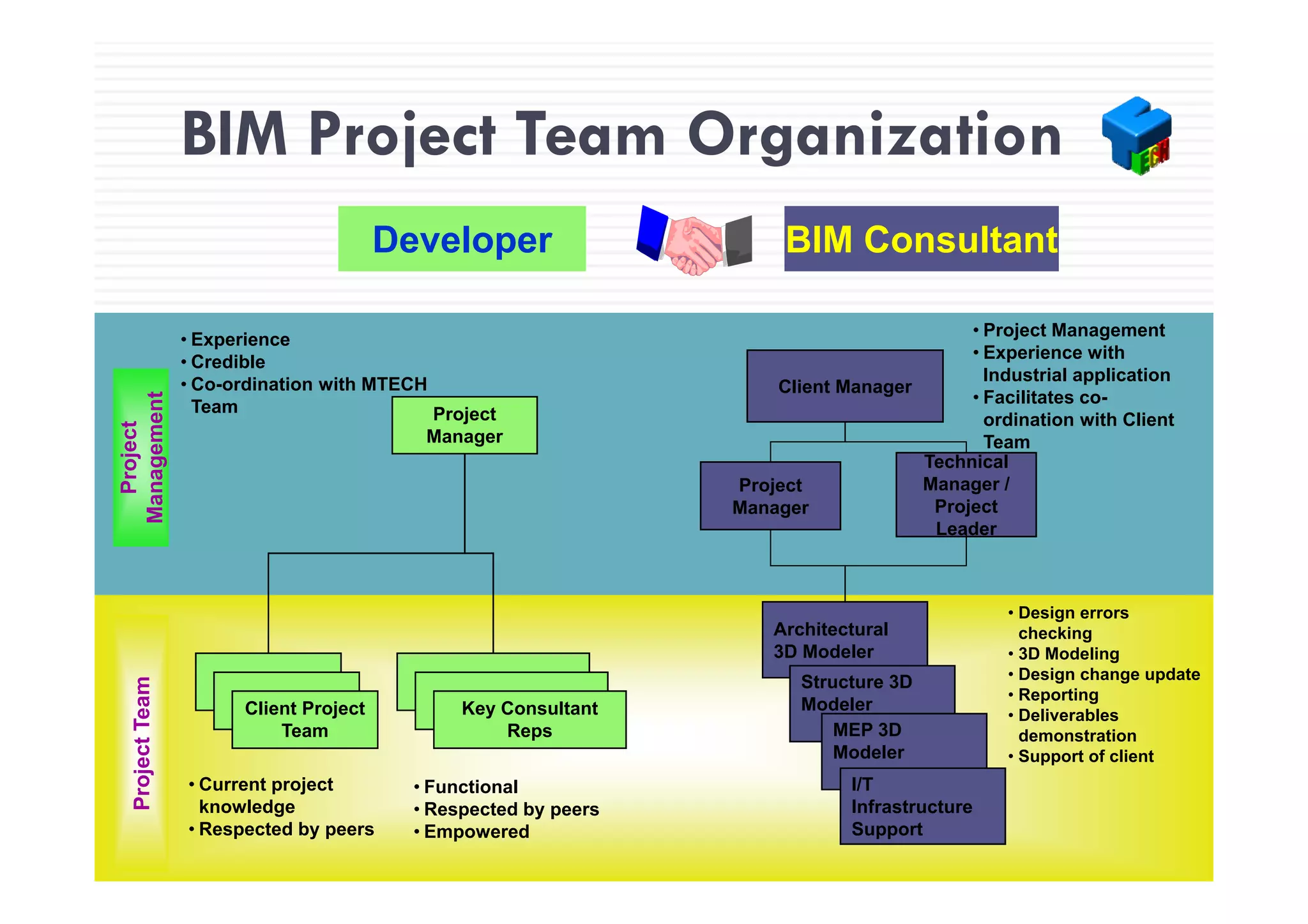

BIM Project Team Organization
Developer BIM Consultant
BIM Project Team Organization
Developer BIM Consultant
• Experience
C dibl
• Project Management
• Experience with
oject
gement
• Credible
• Co-ordination with MTECH
Team Project
Manager
Experience with
Industrial application
• Facilitates co-
ordination with Client
Team
Client Manager
Technical
Pro
Manag
Project
Manager
Technical
Manager /
Project
Leader
Key FunctionalTechnical
Architectural
3D Modeler
• Design errors
checking
• 3D Modeling
Design change updateKey Functional
RepsKey Functional
RepsKey Consultant
Reps
Technical
TeamTechnical
TeamClient Project
Team
ojectTeam
Structure 3D
Modeler
MEP 3D
Modeler
• Design change update
• Reporting
• Deliverables
demonstration
• Support of client
Pro
• Current project
knowledge
• Respected by peers
• Functional
• Respected by peers
• Empowered
I/T
Infrastructure
Support

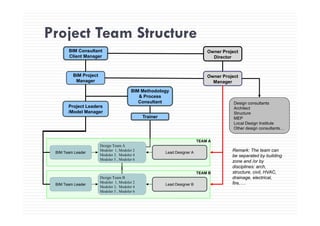

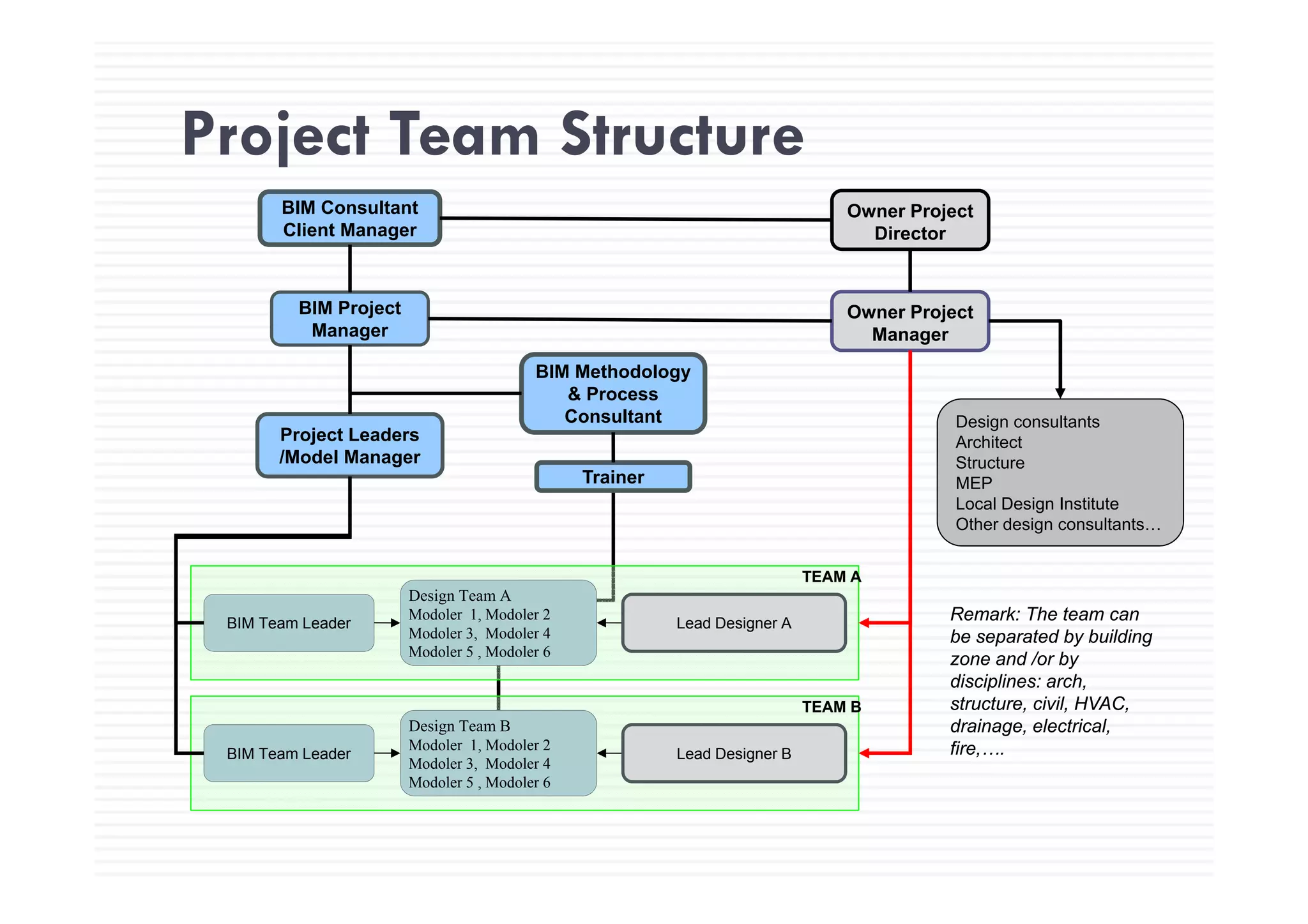

Project Team StructureProject Team Structure
BIM Consultant
Client Manager
Owner Project
Director
Owner Project
Manager
BIM Project
Manager
Project Leaders
/Model Manager
BIM Methodology
& Process
Consultant Design consultants
Architect
Structure/Model Manager
Trainer
Structure
MEP
Local Design Institute
Other design consultants…
Design Team A
Modoler 1, Modoler 2
Modoler 3, Modoler 4
Modoler 5 , Modoler 6
BIM Team Leader Lead Designer A
TEAM A
Remark: The team can
be separated by building
zone and /or by
Design Team B
Modoler 1, Modoler 2
Modoler 3, Modoler 4
BIM Team Leader Lead Designer B
TEAM B
disciplines: arch,
structure, civil, HVAC,
drainage, electrical,
fire,….
Modoler 5 , Modoler 6

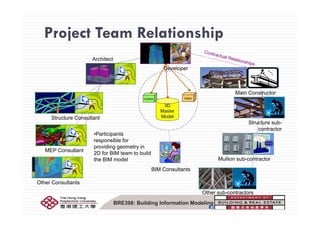

Project Team RelationshipProject Team Relationship
Architect
Developer
3D
Master
Main Constructor
InboxOutbox
ModelStructure Consultant
Structure sub-
contractor
•Participants
ibl f
MEP Consultant
Mullion sub-contractor
responsible for
providing geometry in
2D for BIM team to build
the BIM model
Other Consultants
BIM Consultants
BRE398: Building Information Modeling
Other sub-contractors

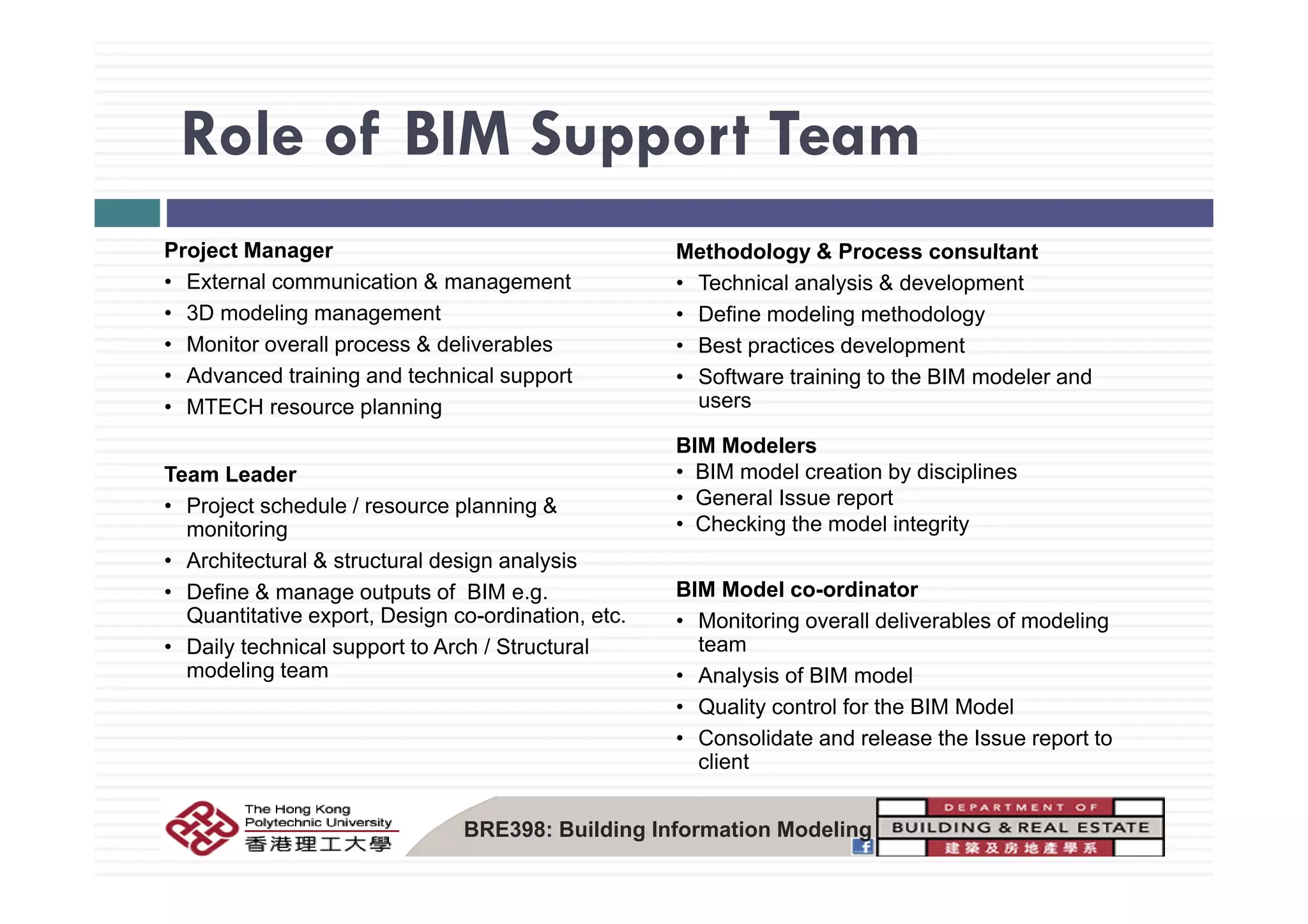

Role of BIM Support Team
Methodology & Process consultantProject Manager
Role of BIM Support Team
Methodology & Process consultant
• Technical analysis & development
• Define modeling methodology
• Best practices development
Project Manager
• External communication & management
• 3D modeling management
• Monitor overall process & deliverables
• Software training to the BIM modeler and
users
• Advanced training and technical support
• MTECH resource planning
BIM Modelers
Team Leader
• Project schedule / resource planning &
monitoring
• Architectural & structural design analysis
• BIM model creation by disciplines
• General Issue report
• Checking the model integrity
Architectural & structural design analysis
• Define & manage outputs of BIM e.g.
Quantitative export, Design co-ordination, etc.
• Daily technical support to Arch / Structural
modeling team
BIM Model co-ordinator
• Monitoring overall deliverables of modeling
team
Analysis of BIM modelmodeling team • Analysis of BIM model
• Quality control for the BIM Model
• Consolidate and release the Issue report to
client
BRE398: Building Information Modeling
Skill ManagementSkill Management
I di t j t t b ’ t BIM kill b li ti lIndicate project team members’ current BIM skills by listing personnel
type, number of employees of each type, and average skill level
Personnel Type No. of Staff Average BIM Skill / Knowledge Levely g g
Project Director 1 Novice
BIM Manager 1 Average
Project Leader 2 Average
Modeller 1 Expert in Revit
5 Expert in CATIA Architecture
Expert in CATIA MEP
Rendering Engineer 2 Expert in 3dsmax
E t i Vi t lExpert in Virtools
Expert in Dreamweaver
3D Simulation Engineer 2 Expert in Cortona3D
BRE398: Building Information Modeling
Software Resources PlanningSoftware Resources Planning
BIM Software
3D
2D
Rendering SoftwareRendering Software
Project Management Software
Data Management & Process control Software
MS Office
…..
BRE398: Building Information Modeling
2013/10/17MTECH..............Confidential

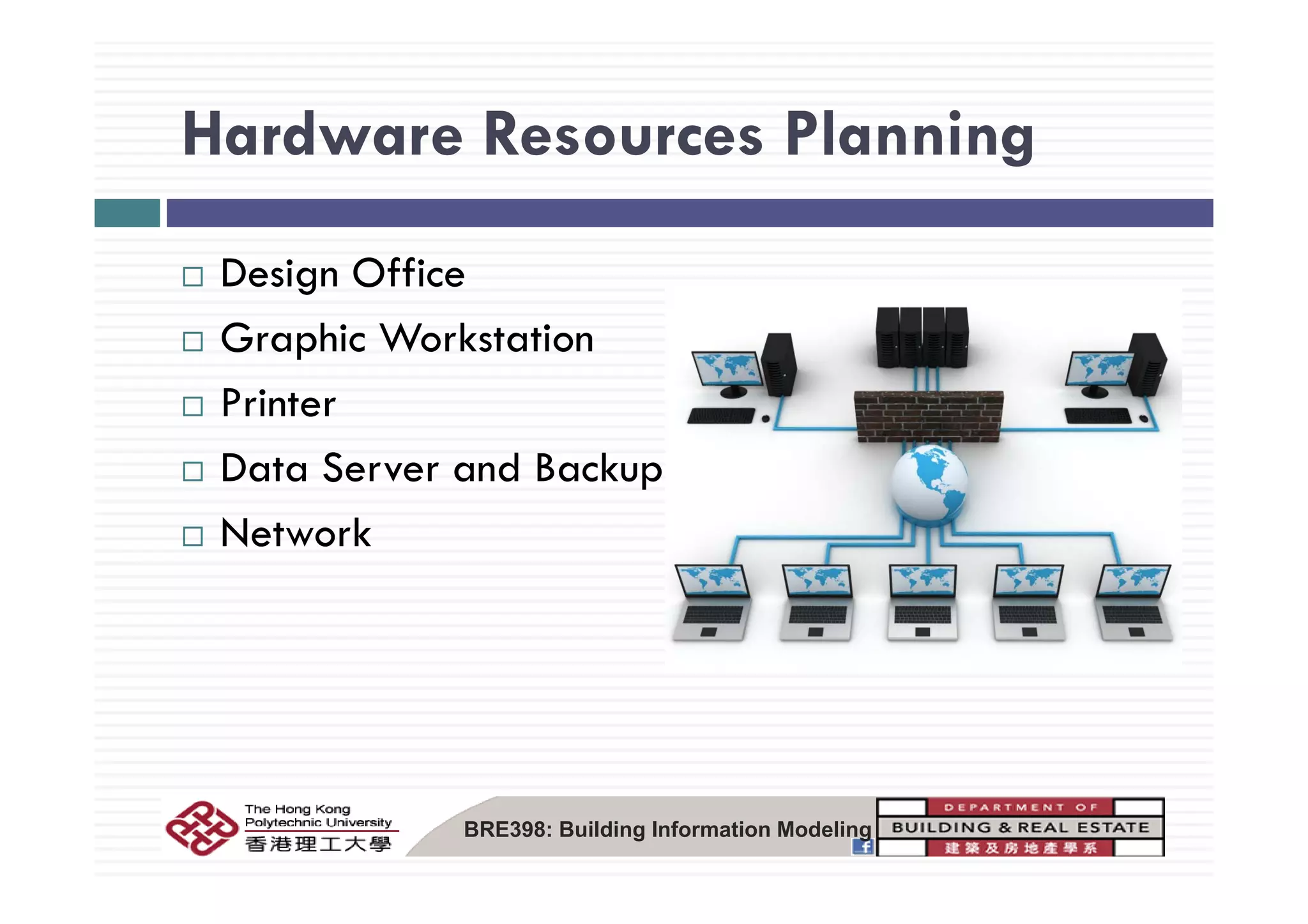

Hardware Resources PlanningHardware Resources Planning
Design Office
Graphic Workstationp
Printer
D t S d B kData Server and Backup
Network
BRE398: Building Information Modeling
TopicsTopics
BIM Project Execution Plan
Project Organization Structurej g
BIM Data Model Structure
P j t I l t ti P & C i tiProject Implementation Process & Communication
Quality & Risk Management
BRE398: Building Information Modeling

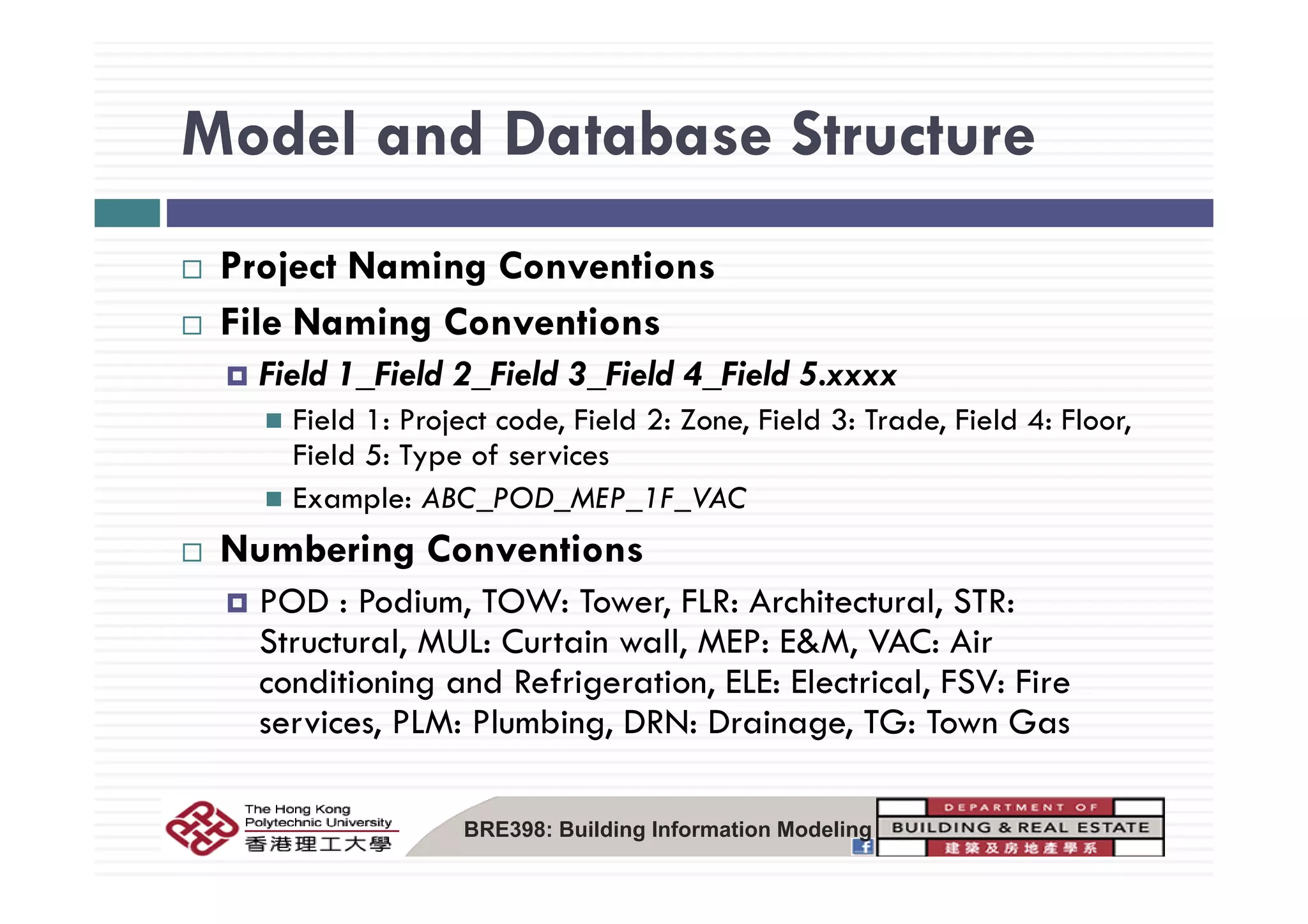

Model and Database StructureModel and Database Structure
P j N i C iProject Naming Conventions
File Naming Conventions
Field 1_Field 2_Field 3_Field 4_Field 5.xxxx
Field 1: Project code, Field 2: Zone, Field 3: Trade, Field 4: Floor,
Field 5: Type of servicesField 5: Type of services
Example: ABC_POD_MEP_1F_VAC
Numbering Conventionsg
POD : Podium, TOW: Tower, FLR: Architectural, STR:
Structural, MUL: Curtain wall, MEP: E&M, VAC: Air
di i i d R f i i ELE El i l FSV Ficonditioning and Refrigeration, ELE: Electrical, FSV: Fire
services, PLM: Plumbing, DRN: Drainage, TG: Town Gas
BRE398: Building Information Modeling
Model StructureModel Structure
The success of a BIM enabled project delivery process is highly dependent upon the level atThe success of a BIM enabled project delivery process is highly dependent upon the level at
which the entire project team can communicate and work collaboratively for the duration of
the project.
For buildings with a large footprint or multiple floors, the project team may split the model into
l ( fl ) ith th di t dseveral zones (or floors) with the corresponding trades
All trades will be modeled at the correct elevation
All elements of the building must be represented in only one file and should be modeled by
their specific trade. (For example, the architectural model provided for 3D Coordinationp ( p , p
should not include any of the structural elements contained in the structural model. Lights should
be modeled by the electrical engineer, not the architect)
All 3D model files must strip extraneous 2D and/or 3D elements from the model before
submission for clash detectionsubmission for clash detection
The architectural ceilings should contain information of lights, diffuser, speaker, CCTV, etc. as
required by design. (For example, lights are to be centered on a grid with proper spacing)
All models should include separate 3D representations of required clearances and/or access
i f i li h l h d bl Threquirements for equipment access, light clearances, overhead cable tray access, etc. These
clearance/access models should be in a separate layer(s)/level(s) per each trade and labeled
as such
BRE398: Building Information Modeling

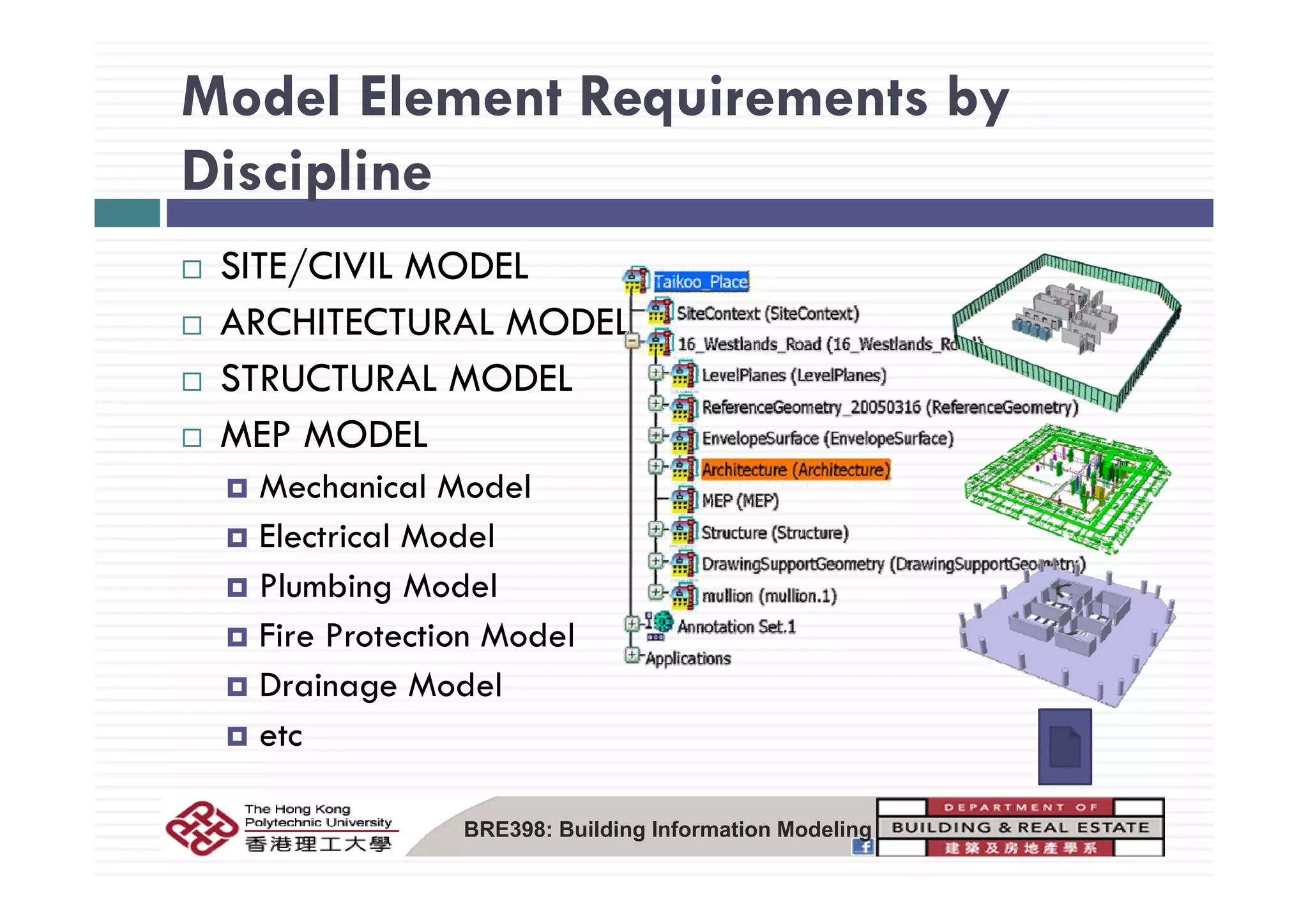

Model Element Requirements by
Discipline
S /C MOSITE/CIVIL MODEL
ARCHITECTURAL MODEL
STRUCTURAL MODEL
MEP MODEL
Mechanical Model
Electrical Model
Plumbing Model
Fire Protection Model
Drainage Model
etc
BRE398: Building Information Modeling

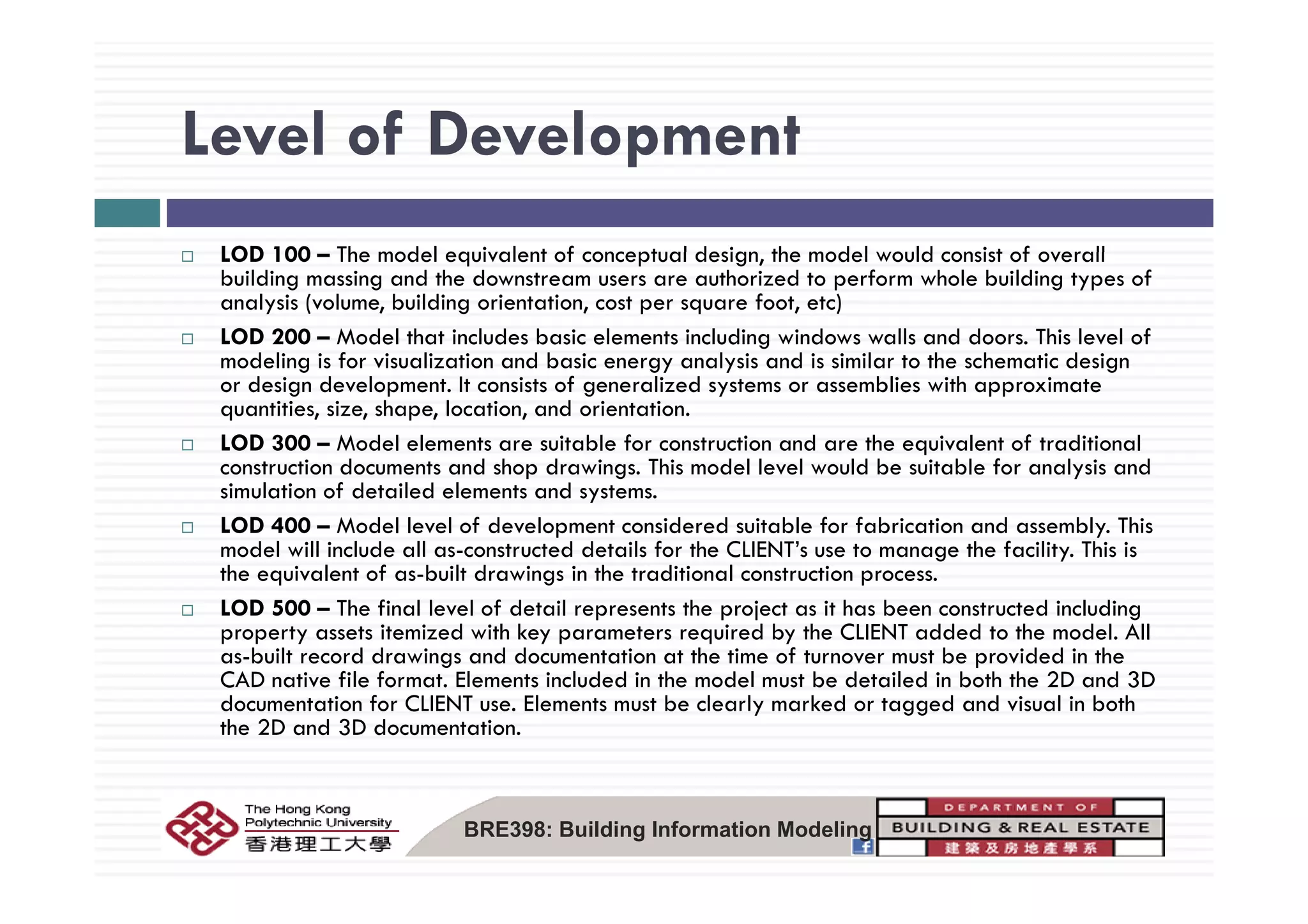

Level of DevelopmentLevel of Development
LOD 100 The model equivalent of conceptual design the model would consist of overallLOD 100 – The model equivalent of conceptual design, the model would consist of overall
building massing and the downstream users are authorized to perform whole building types of
analysis (volume, building orientation, cost per square foot, etc)
LOD 200 – Model that includes basic elements including windows walls and doors. This level of
d li i f i li ti d b i l i d i i il t th h ti d imodeling is for visualization and basic energy analysis and is similar to the schematic design
or design development. It consists of generalized systems or assemblies with approximate
quantities, size, shape, location, and orientation.
LOD 300 – Model elements are suitable for construction and are the equivalent of traditional
t ti d t d h d i Thi d l l l ld b it bl f l i dconstruction documents and shop drawings. This model level would be suitable for analysis and
simulation of detailed elements and systems.
LOD 400 – Model level of development considered suitable for fabrication and assembly. This
model will include all as-constructed details for the CLIENT’s use to manage the facility. This is
h i l f b il d i i h di i l ithe equivalent of as-built drawings in the traditional construction process.
LOD 500 – The final level of detail represents the project as it has been constructed including
property assets itemized with key parameters required by the CLIENT added to the model. All
as-built record drawings and documentation at the time of turnover must be provided in the
CAD f l f El l d d h d l b d l d b h h 2D d 3DCAD native file format. Elements included in the model must be detailed in both the 2D and 3D
documentation for CLIENT use. Elements must be clearly marked or tagged and visual in both
the 2D and 3D documentation.
BRE398: Building Information Modeling
Example of LODExample of LOD
Structure beam, column, slab and staircase Curtain wall/window wall
Chilled water pump and valveFan coil unit, air duct and chilled water pipe

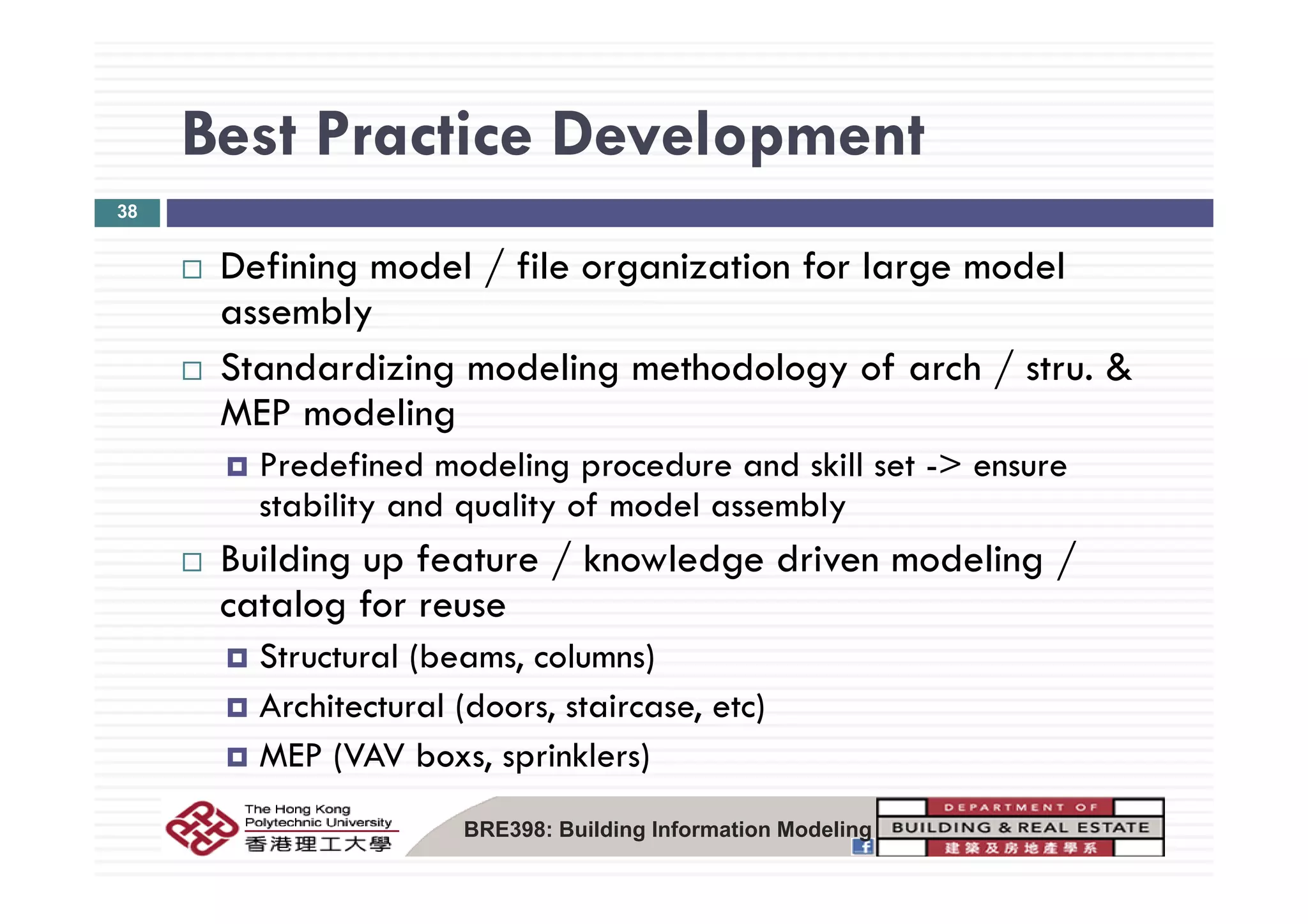

Best Practice DevelopmentBest Practice Development
38
f d l / f l f l d lDefining model / file organization for large model
assembly
S d di i d li h d l f h / &Standardizing modeling methodology of arch / stru. &
MEP modeling
Predefined modeling procedure and skill set > ensurePredefined modeling procedure and skill set -> ensure
stability and quality of model assembly
Building up feature / knowledge driven modeling /Building up feature / knowledge driven modeling /
catalog for reuse
Structural (beams, columns)( , )
Architectural (doors, staircase, etc)
MEP (VAV boxs, sprinklers)
BRE398: Building Information Modeling
TopicsTopics
BIM Project Execution Plan
Project Organization Structurej g
BIM Data Model Structure
P j t I l t ti P & C i tiProject Implementation Process & Communication
Quality & Risk Management
BRE398: Building Information Modeling

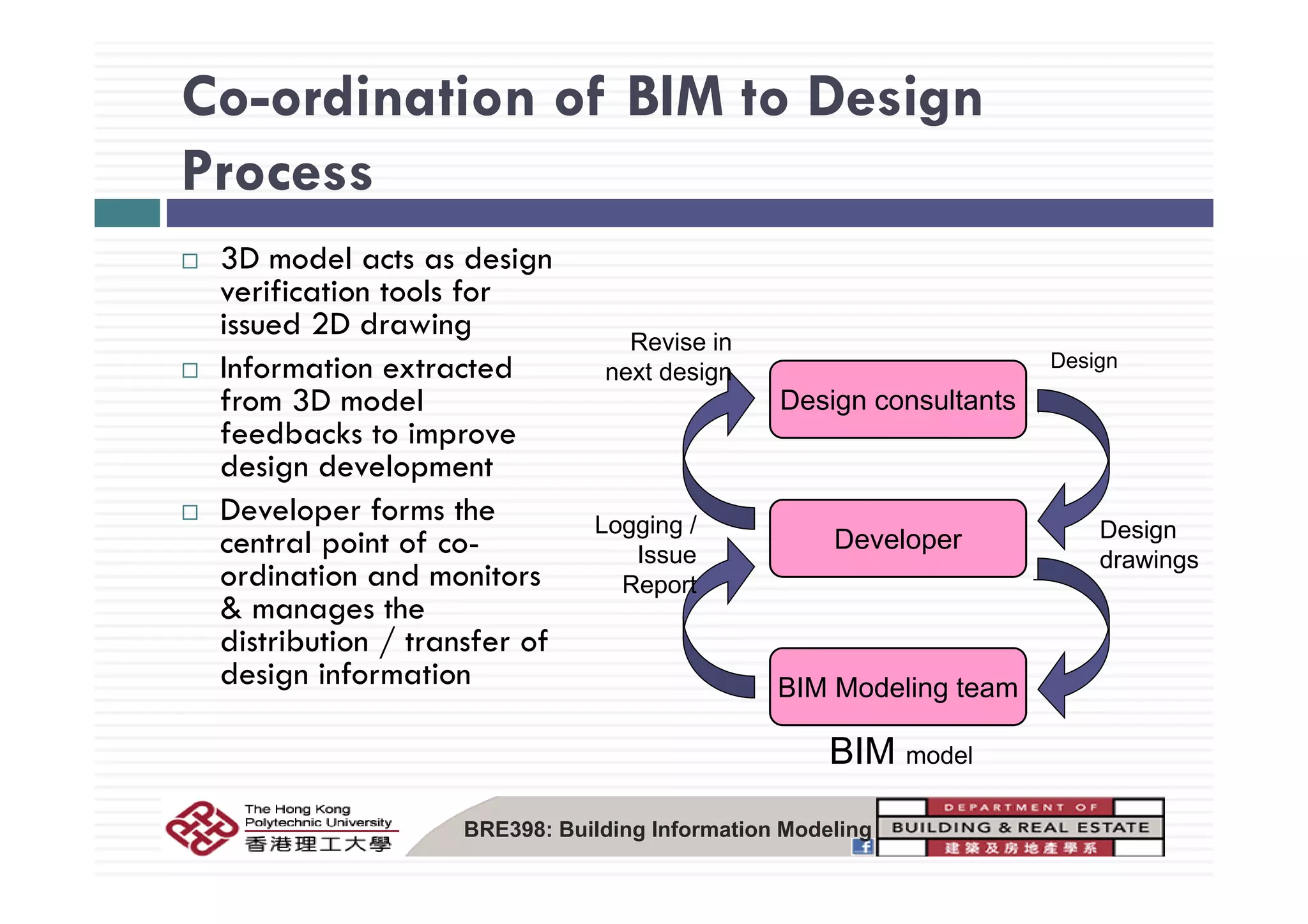

Co-ordination of BIM to Design
Process
3D d l t d i
Revise in
Design
3D model acts as design
verification tools for
issued 2D drawing
I f d
Design consultants
next design DesignInformation extracted
from 3D model
feedbacks to improve
d i d l t
Design
drawings
Developer
Logging /
Issue
design development
Developer forms the
central point of co-
di i d i
drawings
Reportordination and monitors
& manages the
distribution / transfer of
design information BIM Modeling team
BIM model
design information
BRE398: Building Information Modeling
Collaboration: Conceptual ViewCollaboration: Conceptual View
Project Manager
Architect
Work
Model
Wo
MEP
orkSubmis
Work
BIM Master
Model
sions
Work
ModelQS
Issued
Master
Archive
Master
Update
Structural
Work
Model
Master
Model
Model
Review &
Approval
QS
Work
3D Coordinator
Inbox
Architect
Approval Work
Model

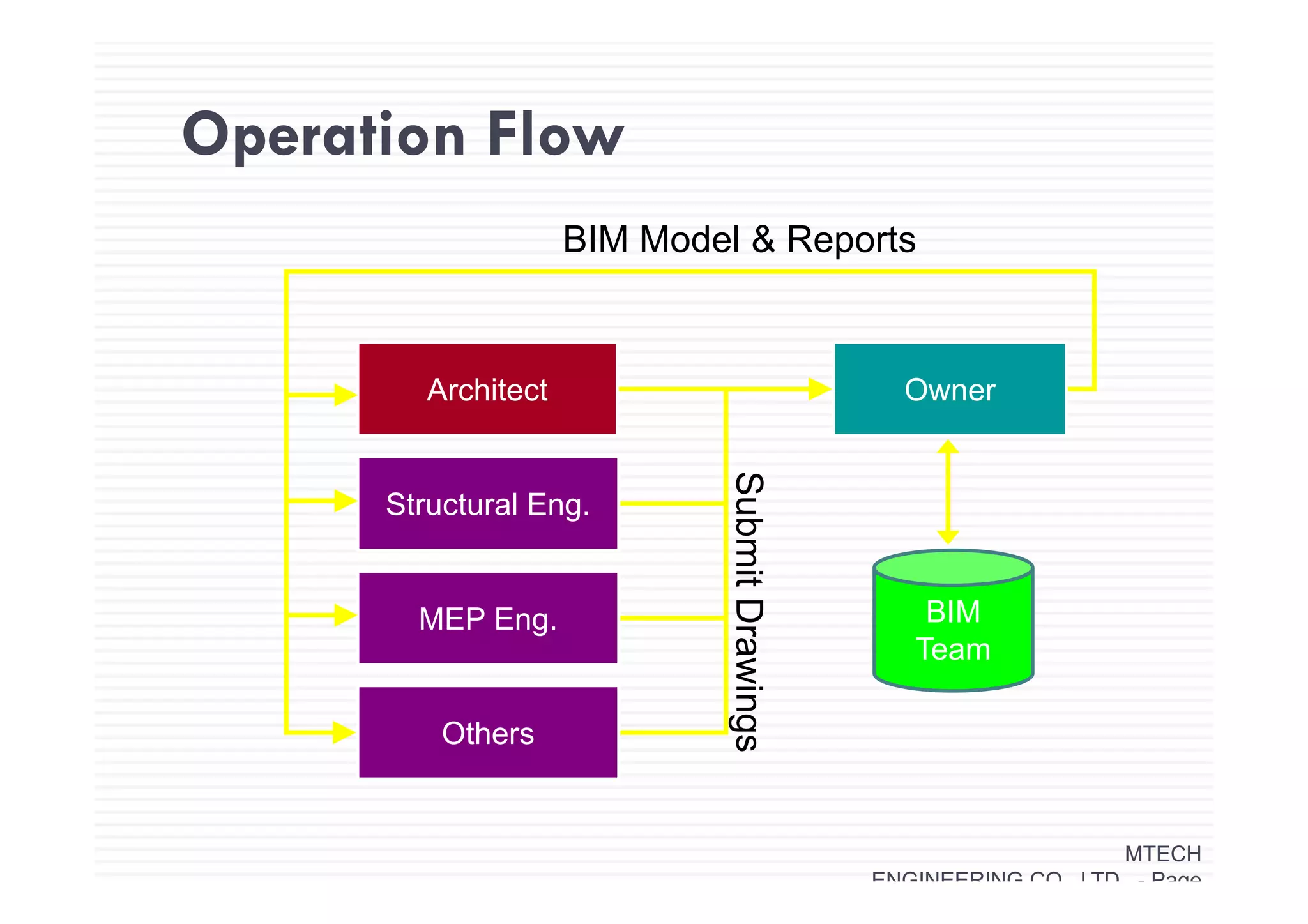

Operation FlowOperation Flow
BIM Model & Reportsode & epo s
OwnerArchitect
Structural Eng.
Subm
MEP Eng.
itDraw
BIM
Team
Others wings
MTECH
ENGINEERING CO LTD - Page

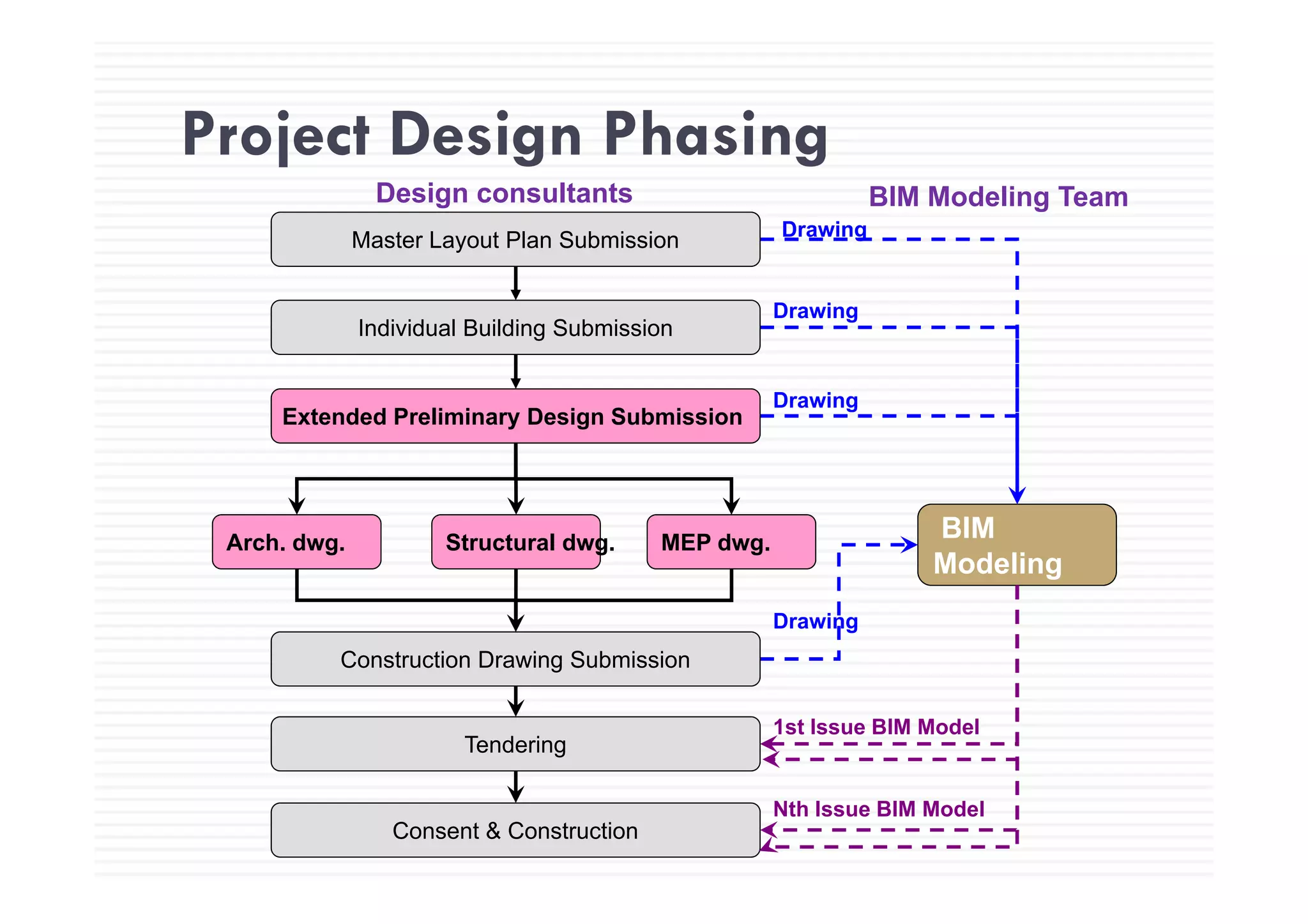

Project Design Phasing
Master Layout Plan Submission Drawing
Design consultants BIM Modeling Team
Project Design Phasing
Individual Building Submission
y
Drawing
Extended Preliminary Design Submission
Drawing
Arch. dwg. Structural dwg. MEP dwg.
BIM
ModelingModeling
Construction Drawing Submission
Drawing
g
Tendering
1st Issue BIM Model
Consent & Construction
Nth Issue BIM Model

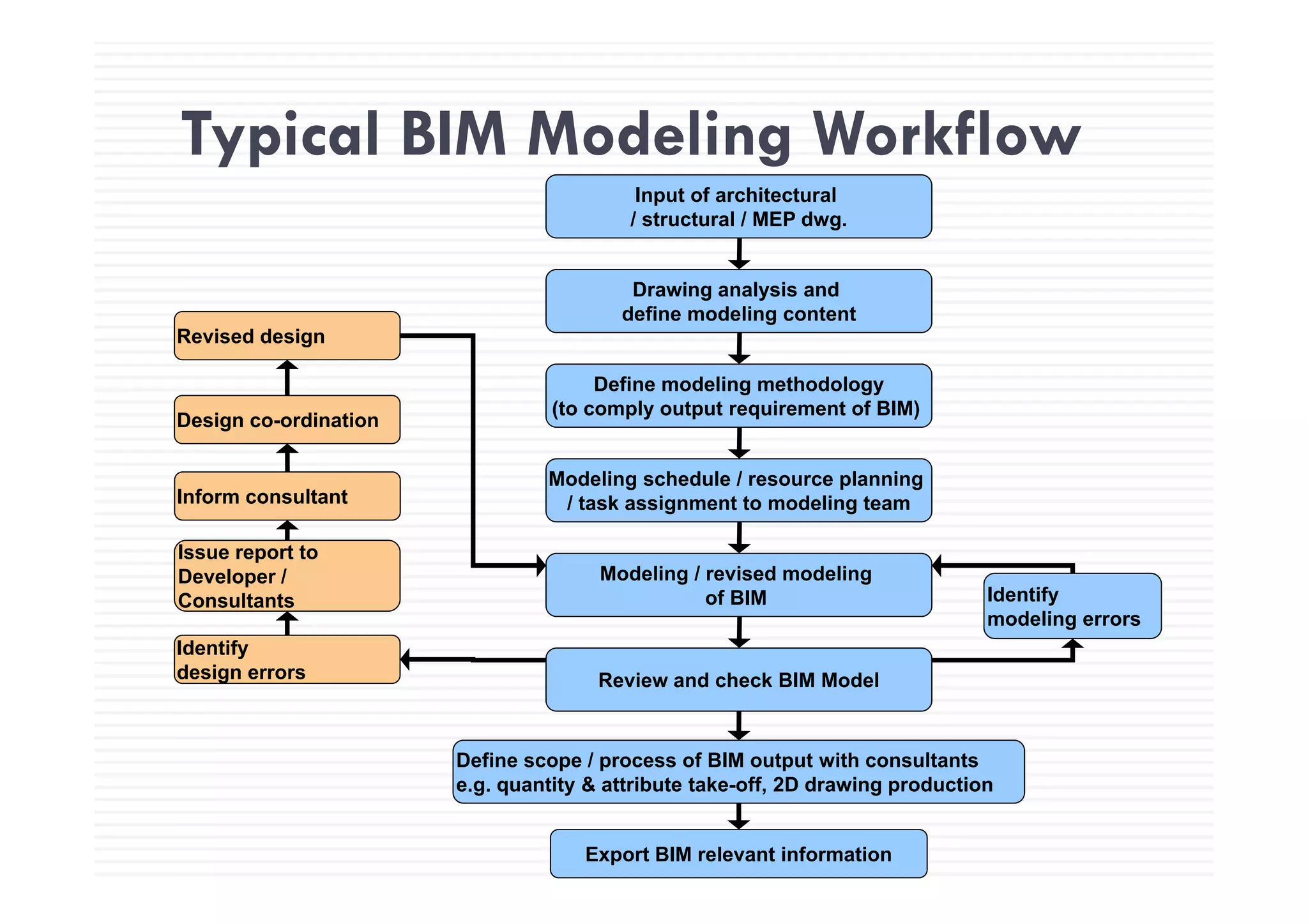

Typical BIM Modeling Workflow
Input of architectural
/ structural / MEP dwg.
Typical BIM Modeling Workflow
Drawing analysis and
define modeling content
Revised design
Define modeling methodology
(to comply output requirement of BIM)
Design co-ordination
Modeling schedule / resource planning
/ task assignment to modeling team
M d li / i d d li
Issue report to
Inform consultant
Modeling / revised modeling
of BIM Identify
modeling errors
Identify
design errors
Developer /
Consultants
Review and check BIM Model
Define scope / process of BIM output with consultants
design errors
e.g. quantity & attribute take-off, 2D drawing production
Export BIM relevant information

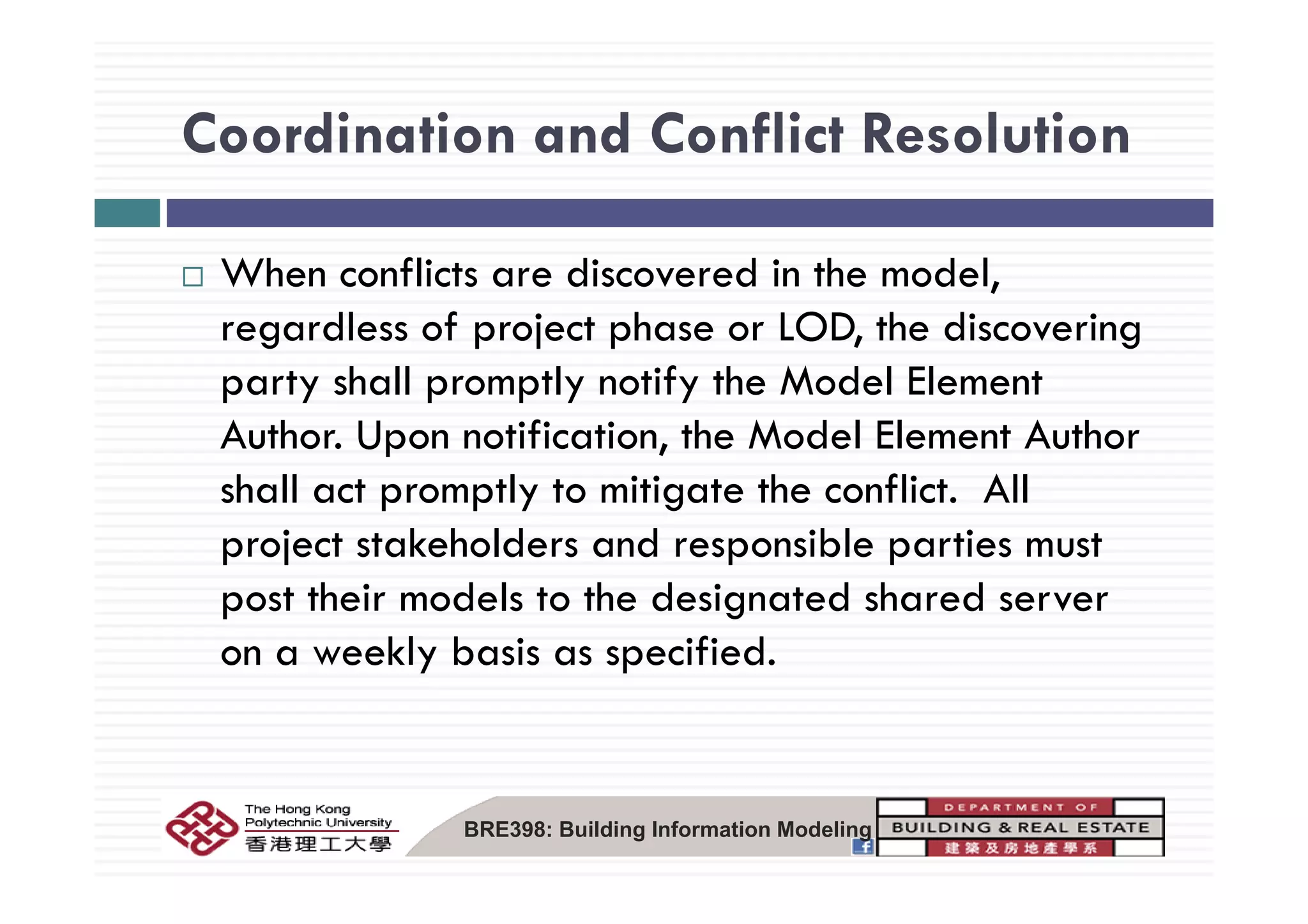

Coordination and Conflict ResolutionCoordination and Conflict Resolution
When conflicts are discovered in the model,
regardless of project phase or LOD, the discovering
party shall promptly notify the Model Element
Author. Upon notification, the Model Element Author
shall act promptly to mitigate the conflict. All
project stakeholders and responsible parties must
post their models to the designated shared server
on a weekly basis as specified.y p
BRE398: Building Information Modeling

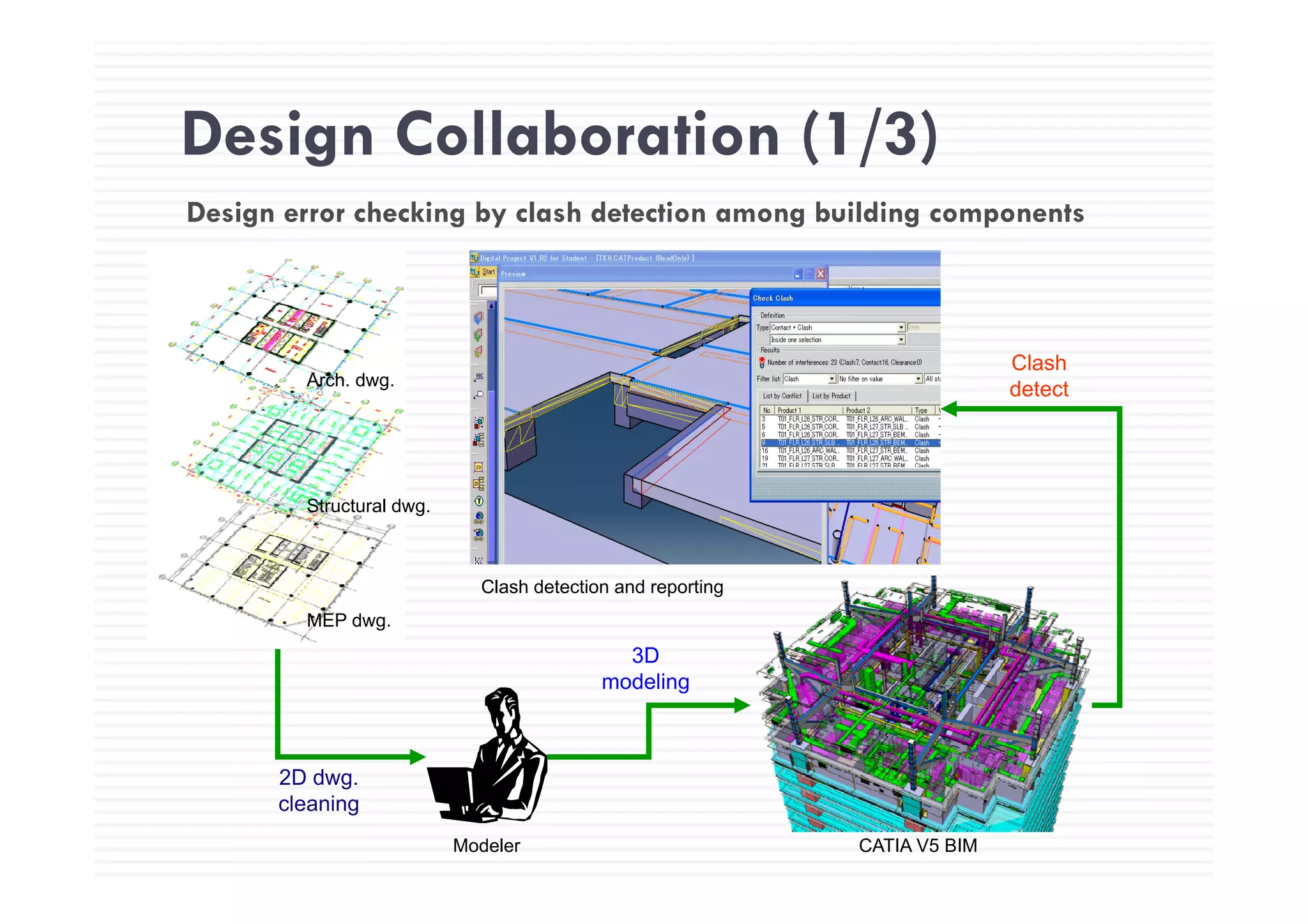

Design Collaboration (1/3)Design Collaboration (1/3)
Design error checking by clash detection among building components
Cl h
Arch. dwg.
Clash
detect
Structural dwg.
MEP dwg.
Clash detection and reporting
3D
2D dwg
modeling
Modeler CATIA V5 BIM
2D dwg.
cleaning
3D Co-ordinated M&E Model3D Co ordinated M&E Model
Direct and automatic detection of design errorDirect and automatic detection of design errorDirect and automatic detection of design errorDirect and automatic detection of design error

Design Collaboration (2/3)Design Collaboration (2/3)
Design review discussing design revision and revised modeling
Design revision is followed to eliminateDesign revision is followed to eliminate
detected errors in CATIA V5 BIM
Design review and collaboration amongDesign review and collaboration among
architect, structural engineer and MEP
engineer
Design & 3D
Modeling
Design Co-ordinate
ti
Revised 3D
d li
Simplified workflow of design collaboration
Modeling error
checking
meeting modeling
Design Collaboration (3/3)Design Collaboration (3/3)

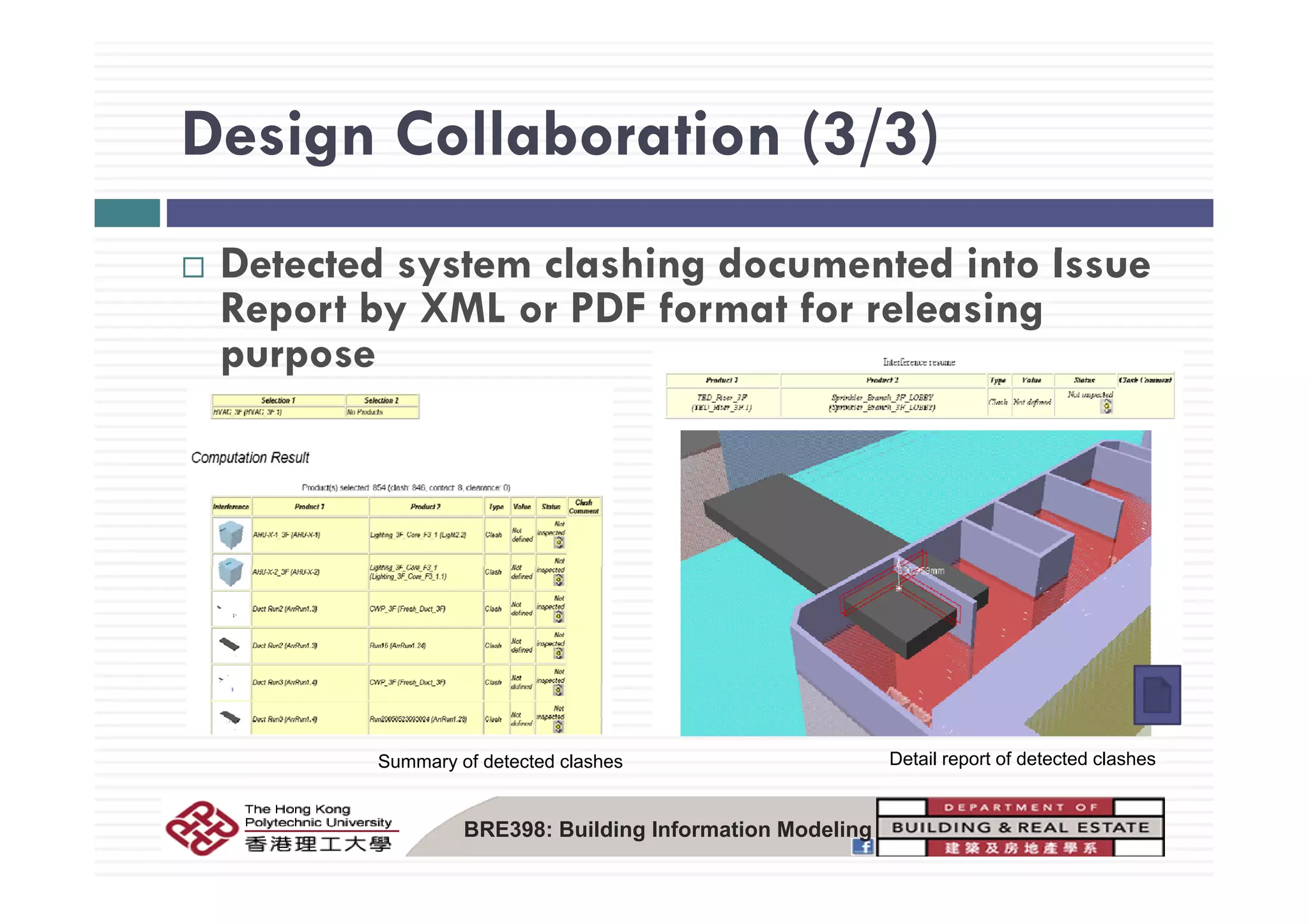

D t t d t l hi d t d i t IDetected system clashing documented into Issue
Report by XML or PDF format for releasing
purposepurpose
Summary of detected clashes Detail report of detected clashes
BRE398: Building Information Modeling
Issue ReportIssue Report
Report of design errors was logged and meetings
h ld li / d i l /were held among clients / design consultants /
support team for design revision
Co-ordination Meeting ProceduresCo ordination Meeting Procedures

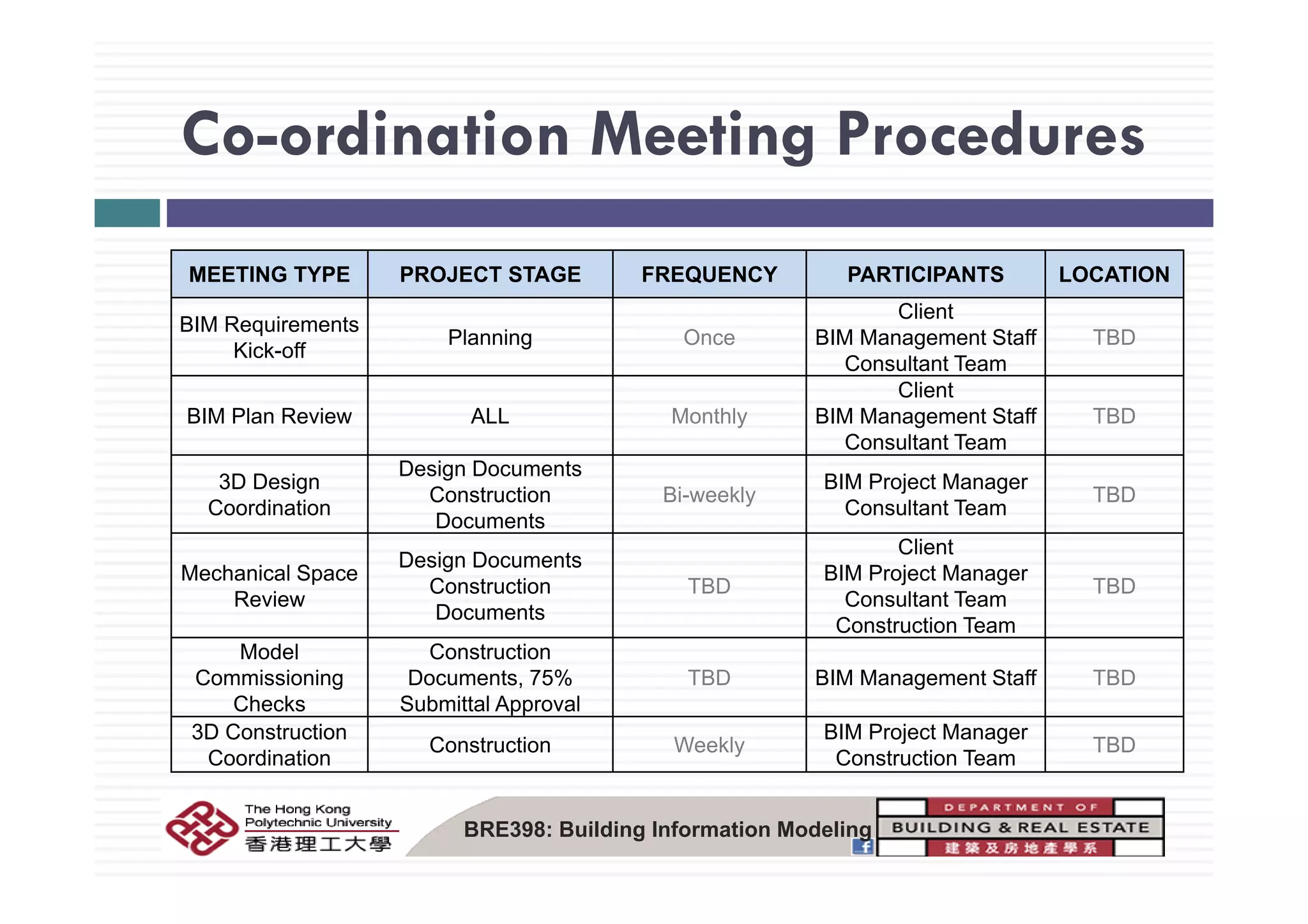

MEETING TYPE PROJECT STAGE FREQUENCY PARTICIPANTS LOCATION
BIM Requirements
Kick-off
Planning Once
Client
BIM Management Staff
C lt t T
TBD
Kick off
Consultant Team
BIM Plan Review ALL Monthly
Client
BIM Management Staff
Consultant Team
TBD
D i D t
3D Design
Coordination
Design Documents
Construction
Documents
Bi-weekly
BIM Project Manager
Consultant Team
TBD
M h i l S
Design Documents
Client
BIM P j t MMechanical Space
Review
Design Documents
Construction
Documents
TBD
BIM Project Manager
Consultant Team
Construction Team
TBD
Model
C i i i
Construction
D t 75% TBD BIM M t St ff TBDCommissioning
Checks
Documents, 75%
Submittal Approval
TBD BIM Management Staff TBD
3D Construction
Coordination
Construction Weekly
BIM Project Manager
Construction Team
TBD
BRE398: Building Information Modeling

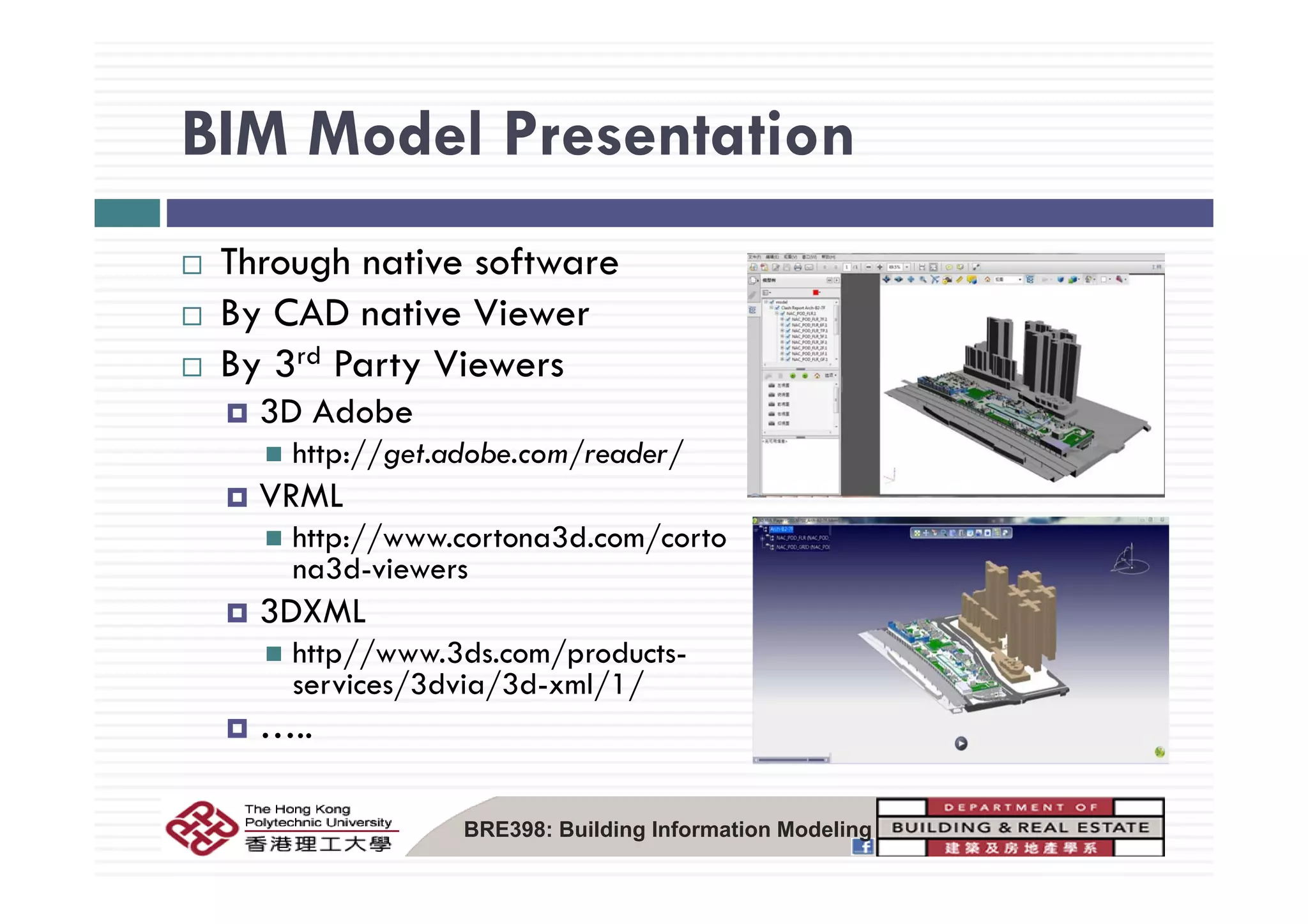

BIM Model PresentationBIM Model Presentation
Th h ti ftThrough native software
By CAD native Viewer
B 3rd P t ViBy 3rd Party Viewers
3D Adobe
http://get.adobe.com/reader/http://get.adobe.com/reader/
VRML
http://www.cortona3d.com/corto
na3d viewersna3d-viewers
3DXML
http//www.3ds.com/products-
/ / / /services/3dvia/3d-xml/1/
…..
BRE398: Building Information Modeling

Selection of 3D ViewerSelection of 3D Viewer
Data compatibility
Functions
Model Size
Contents
3D View
Navigation
Supporting Platform
PCNavigation
Sectioning
Animation
PC
Web
M bil d iAnimation
Measurement
Mobile devices
Security
View capture
Rendering
BRE398: Building Information Modeling

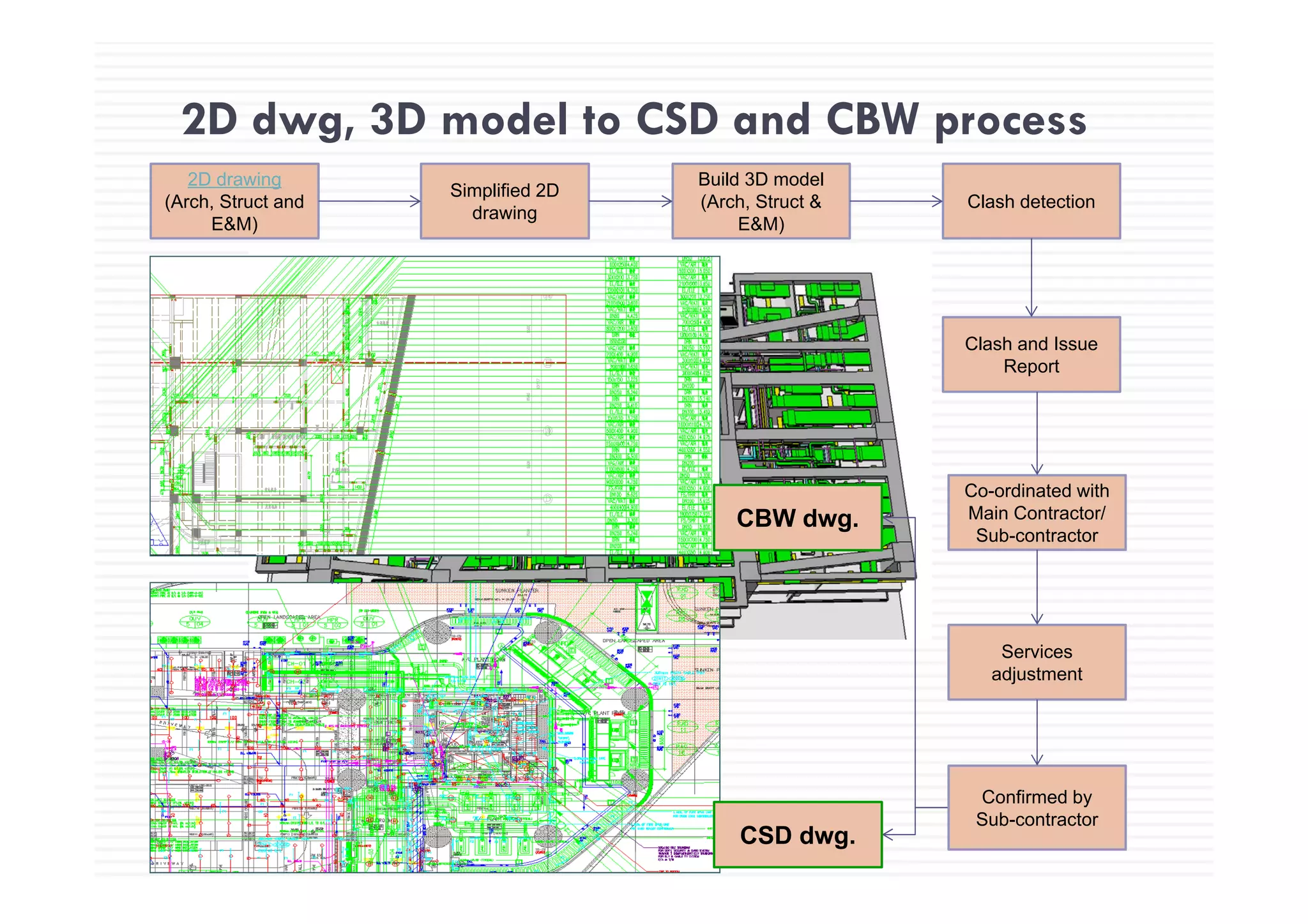

2D dwg, 3D model to CSD and CBW process
2D drawing
(Arch, Struct and
E&M)
Simplified 2D
drawing
Build 3D model
(Arch, Struct &
E&M)
Clash detection
Clash and Issue
Report
Co-ordinated with
Main Contractor/
Sub-contractor
CBW dwg.
Services
adjustmentadjustment
CSD dwg.
Confirmed by
Sub-contractor

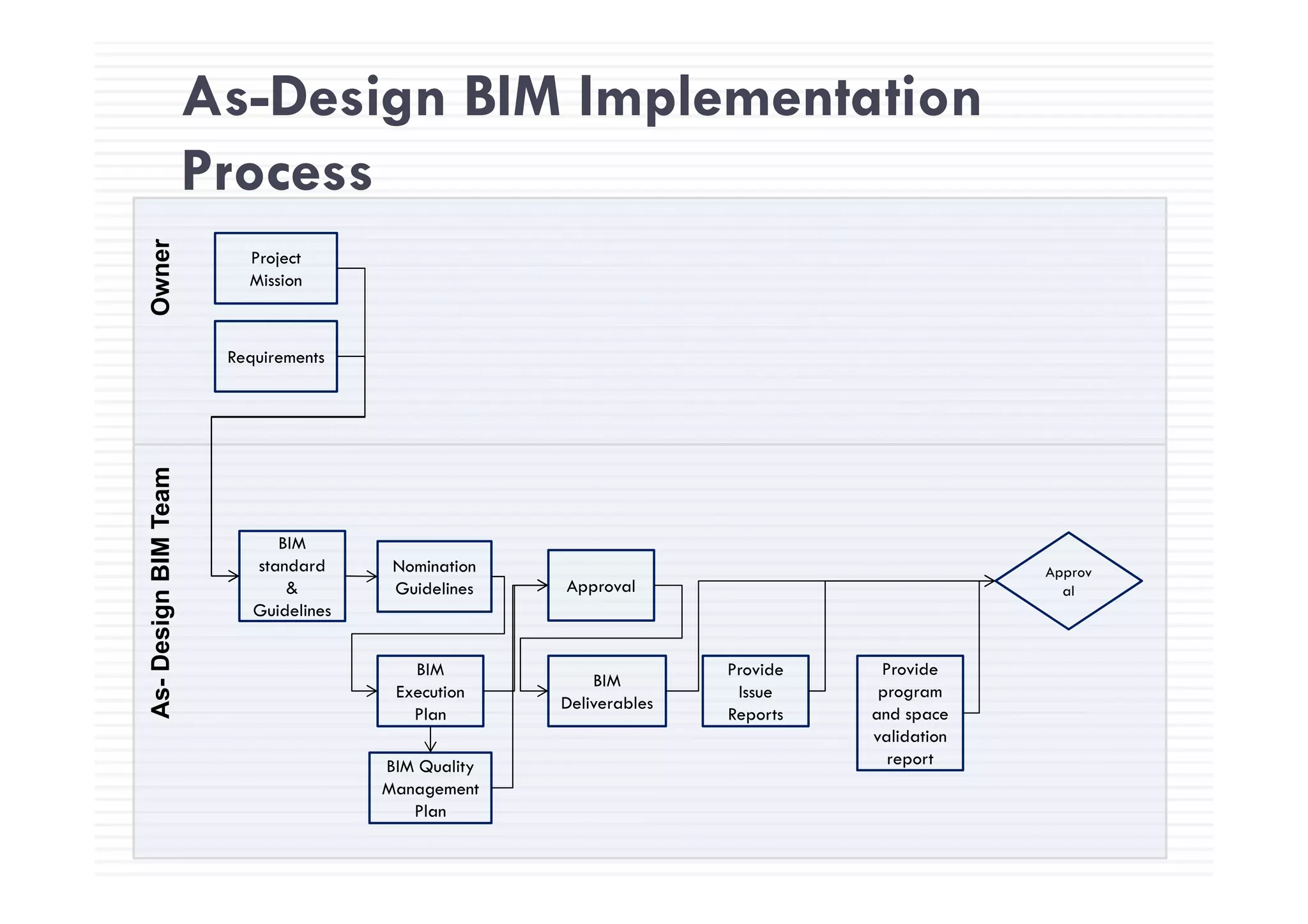

As-Design BIM Implementation
Process
P j
er
Project
Mission
Owne
RequirementsRequirements
BIM
standard Nomination
BIMTeam
standard
&
Guidelines
Nomination
Guidelines
BIM
Approval
Provide Provide
Approv
al
DesignB
BIM
Execution
Plan
BIM
Deliverables
Provide
Issue
Reports
Provide
program
and space
validation
reportBIM Quality
As-
Management
Plan

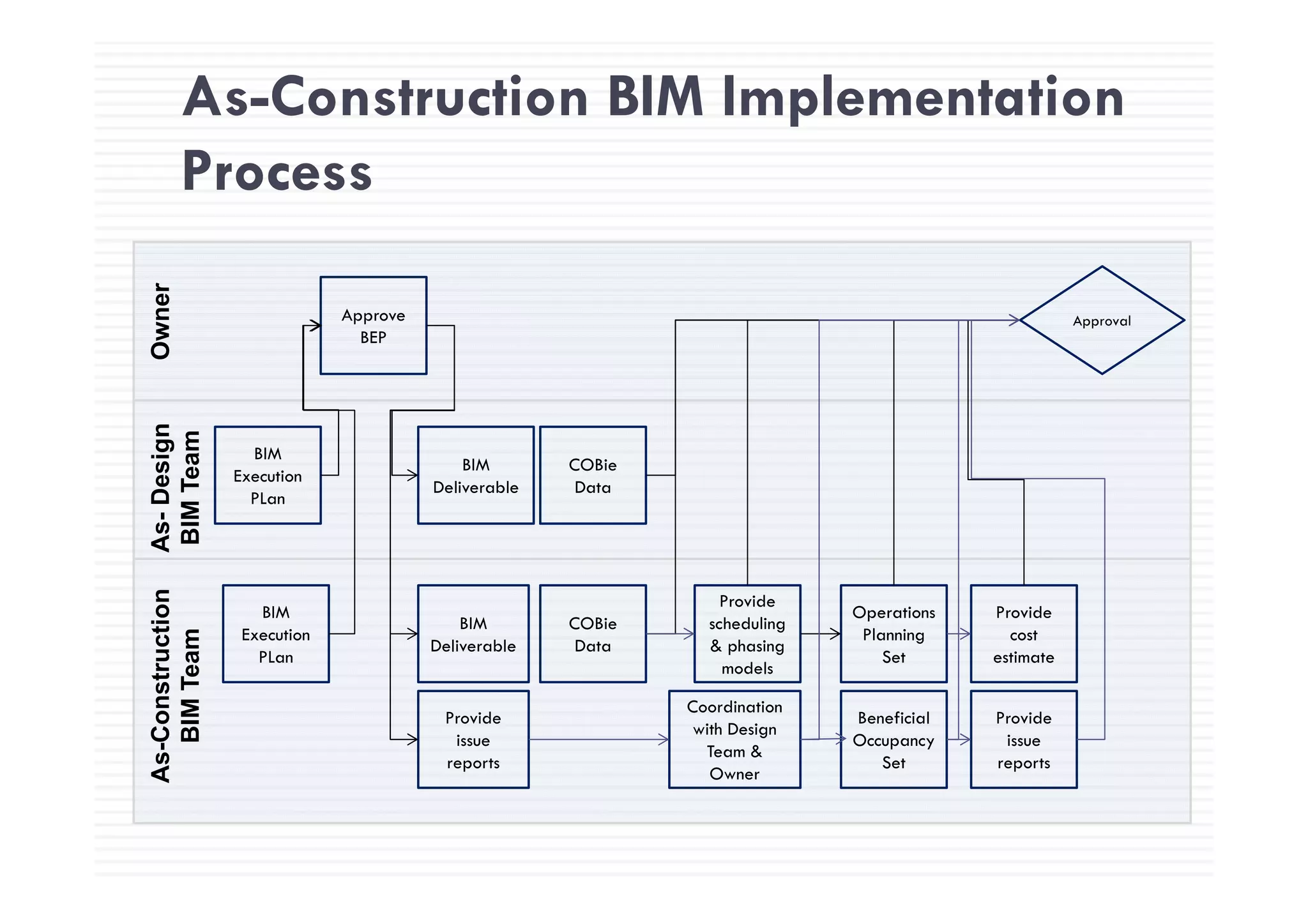

As-Construction BIM Implementation
ProcessOwner
Approve
BEP
Approval
Osign
am
BIM
BIM COBi
As-Des
BIMTea
Execution
PLan
BIM
Deliverable
COBie
Data
ruction
eam
BIM
Execution
PLan
BIM
Deliverable
COBie
Data
Provide
scheduling
& phasing
models
Operations
Planning
Set
Provide
cost
estimate
As-Const
BIMTe
models
Coordination
with Design
Team &
Owner
Provide
issue
reports
Beneficial
Occupancy
Set
Provide
issue
reports
A
Owner
As-Build BIM Implementation
Process
Ensure no
er
Identify
major
equipment
Identify
required
fields
Ensure no
errors or
omissions
Owne
Coordinate
fields,
Equipments,
documentation
Validate
data
Popula
te
data in
fields
Design
Team
Owner as
fields
Update
Add
field
As-D
BIMtion
am
Validate
field data
Validate
field data
Owner as-
build data
deliverable
data
from
approved
submittals
data
when
installe
d
As-
Construct
BIMTea
Add
performanc
e data from
C
Validated
field data
Validate
fields,
equipments
Validate
data
missioning
TeamC
Cxequipments
Comm
T

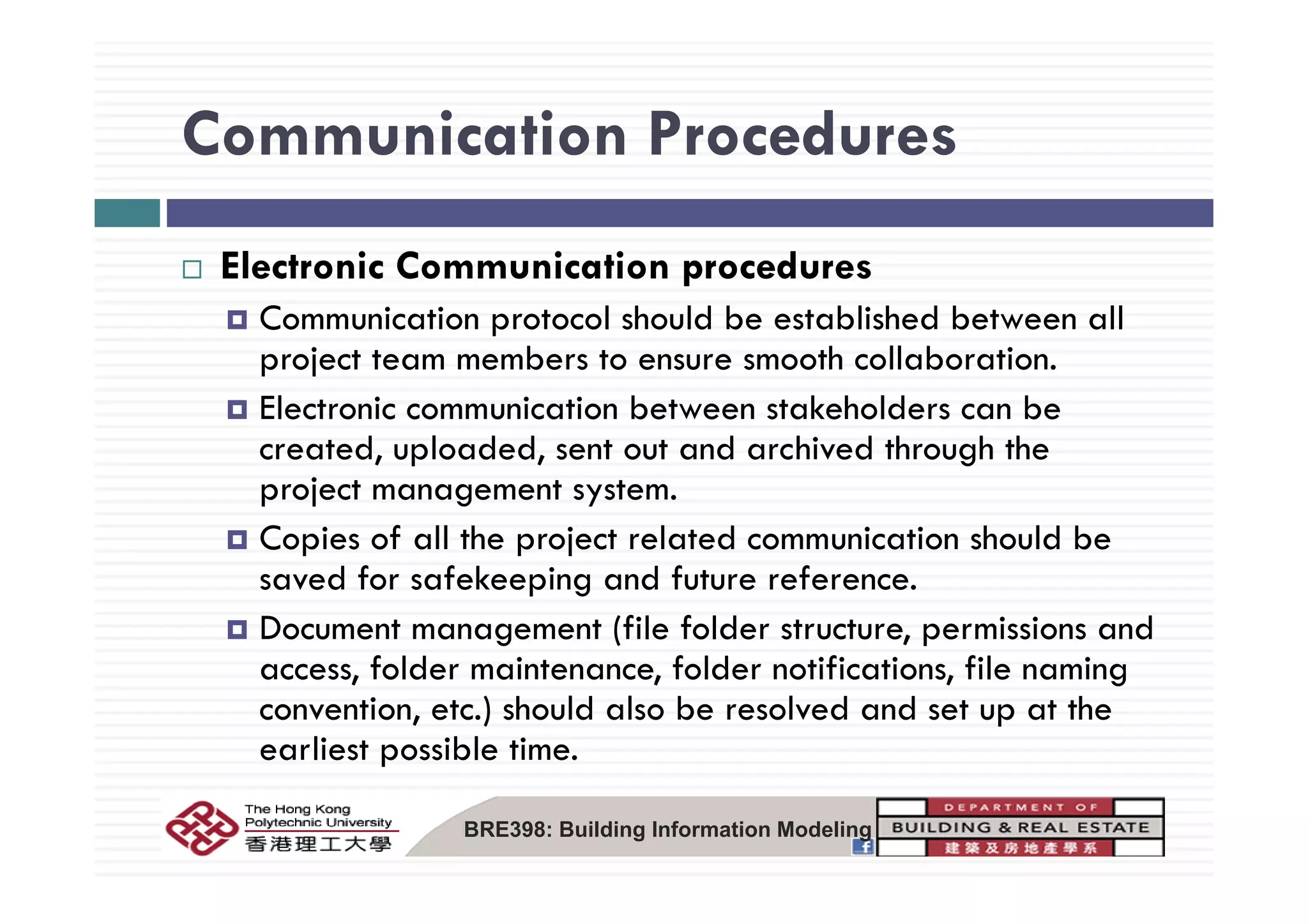

Communication ProceduresCommunication Procedures
El i C i i dElectronic Communication procedures
Communication protocol should be established between all
project team members to ensure smooth collaborationproject team members to ensure smooth collaboration.
Electronic communication between stakeholders can be
created, uploaded, sent out and archived through the, p , g
project management system.
Copies of all the project related communication should be
d f f k d f fsaved for safekeeping and future reference.
Document management (file folder structure, permissions and
access folder maintenance folder notifications file namingaccess, folder maintenance, folder notifications, file naming
convention, etc.) should also be resolved and set up at the
earliest possible time.
BRE398: Building Information Modeling

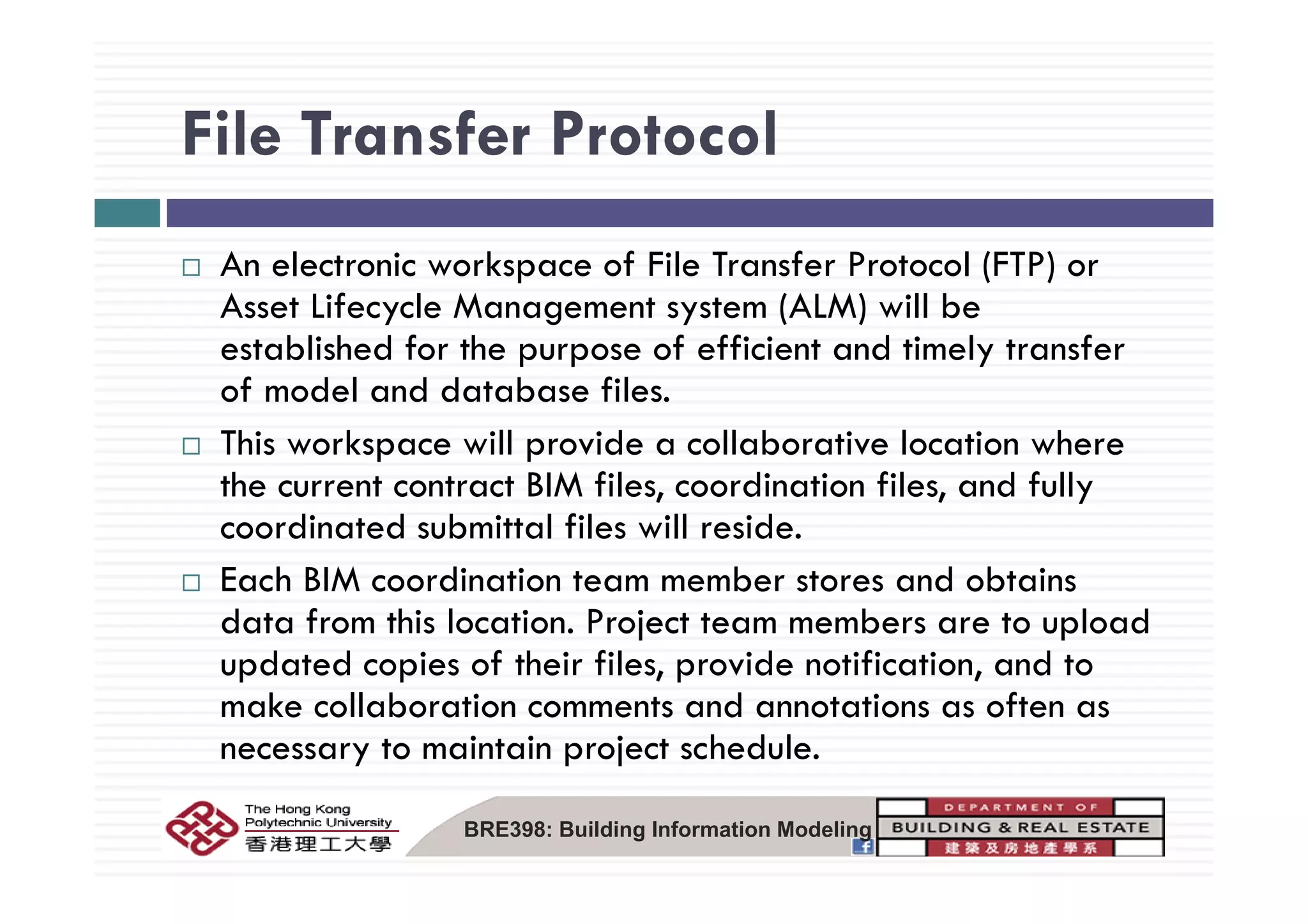

File Transfer ProtocolFile Transfer Protocol
A l k f F l T f P l (FTP)An electronic workspace of File Transfer Protocol (FTP) or
Asset Lifecycle Management system (ALM) will be
established for the purpose of efficient and timely transferestablished for the purpose of efficient and timely transfer
of model and database files.
This workspace will provide a collaborative location where
the current contract BIM files, coordination files, and fully
coordinated submittal files will reside.
h M d b d bEach BIM coordination team member stores and obtains
data from this location. Project team members are to upload
updated copies of their files, provide notification, and toupdated copies of their files, provide notification, and to
make collaboration comments and annotations as often as
necessary to maintain project schedule.
BRE398: Building Information Modeling

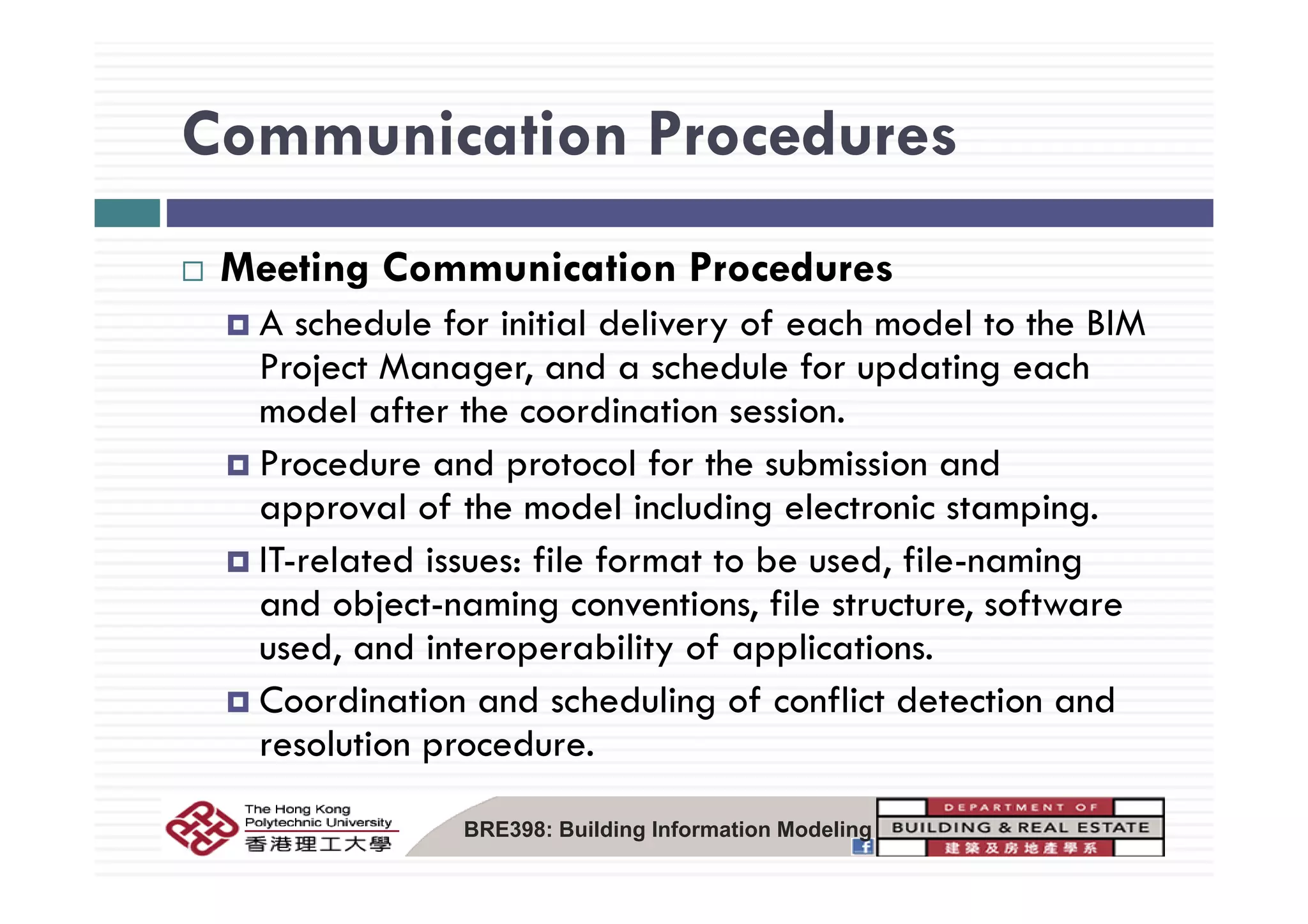

Communication ProceduresCommunication Procedures
M i C i i P dMeeting Communication Procedures
A schedule for initial delivery of each model to the BIM
P j M d h d l f d i hProject Manager, and a schedule for updating each
model after the coordination session.
Procedure and protocol for the submission andProcedure and protocol for the submission and
approval of the model including electronic stamping.
IT-related issues: file format to be used file-namingIT related issues: file format to be used, file naming
and object-naming conventions, file structure, software
used, and interoperability of applications.
Coordination and scheduling of conflict detection and
resolution procedure.
BRE398: Building Information Modeling

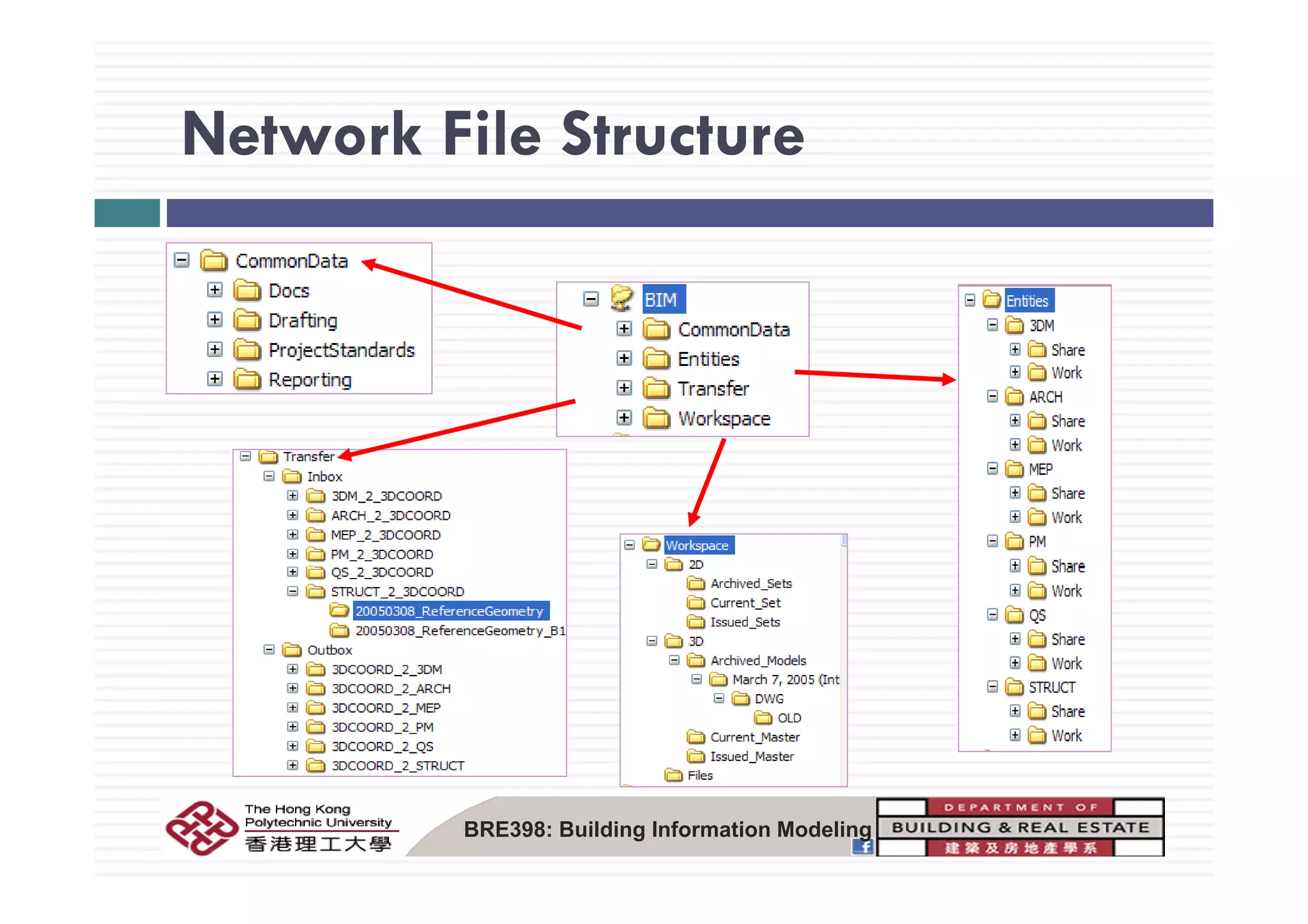

Network File StructureNetwork File Structure
BRE398: Building Information Modeling

Ftp Server Submission & Approval
Process
Architect
Architect
Work
Model
5. Review model
with Architect
3. Checks email
2. Email for
notification of
Structural
3D Coordinator
8. Update status –
Updated in current model
notification of
upload the BIM
model
Structural
Work
Model
1 C fil t f ld
7. Update files to
Current Model
Mail Inbox
MEP
Work
Model ftpbimtransferinbox
1. Copy files to folder
ft bi  k 3d
BRE398: Building Information Modeling
Model ftpbimtransferinbox ftpbimworkspace3d

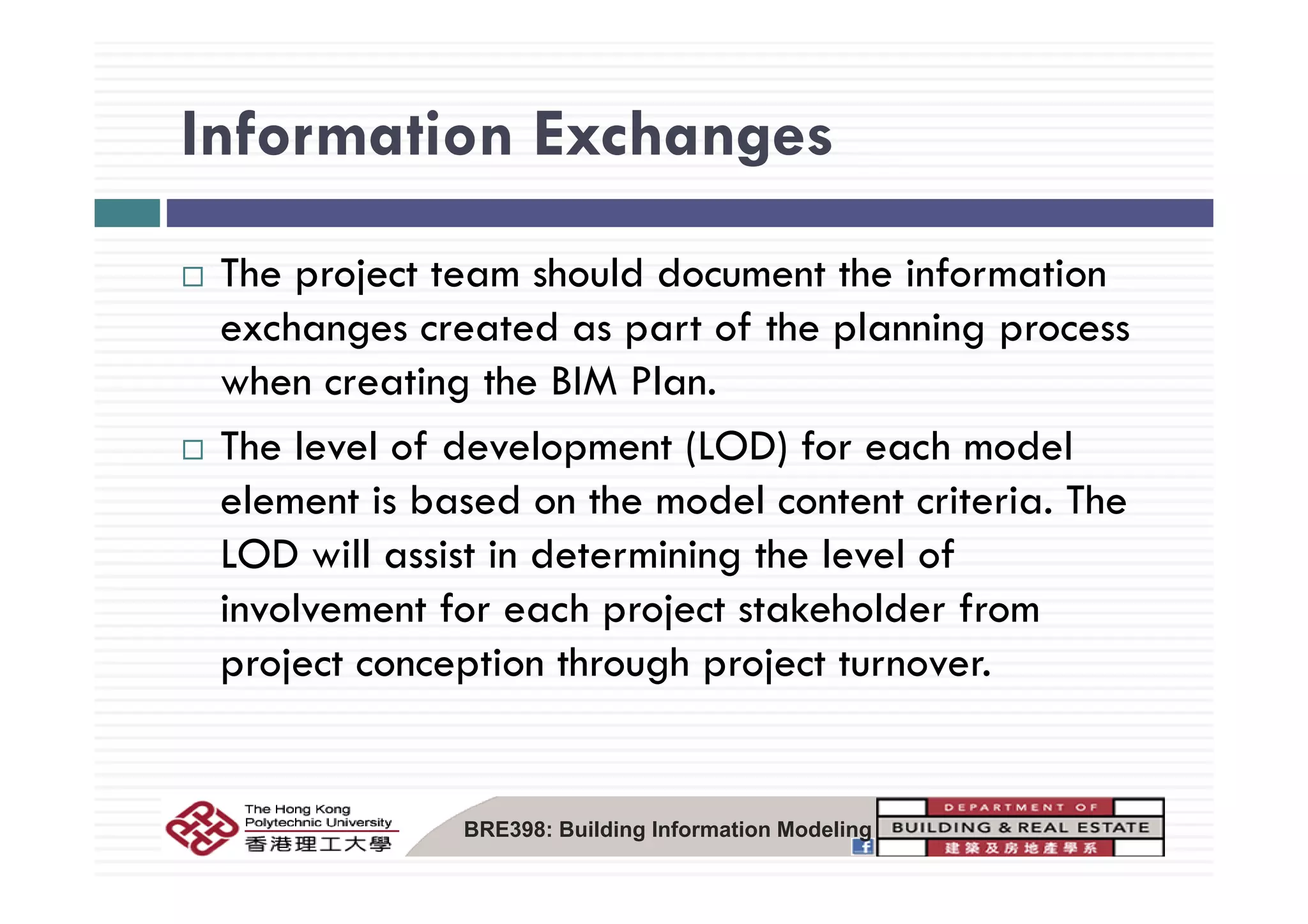

Information ExchangesInformation Exchanges
The project team should document the information
exchanges created as part of the planning process
when creating the BIM Plan.
The level of development (LOD) for each modelp ( )
element is based on the model content criteria. The
LOD will assist in determining the level ofLOD will assist in determining the level of
involvement for each project stakeholder from
project conception through project turnover.project conception through project turnover.
BRE398: Building Information Modeling

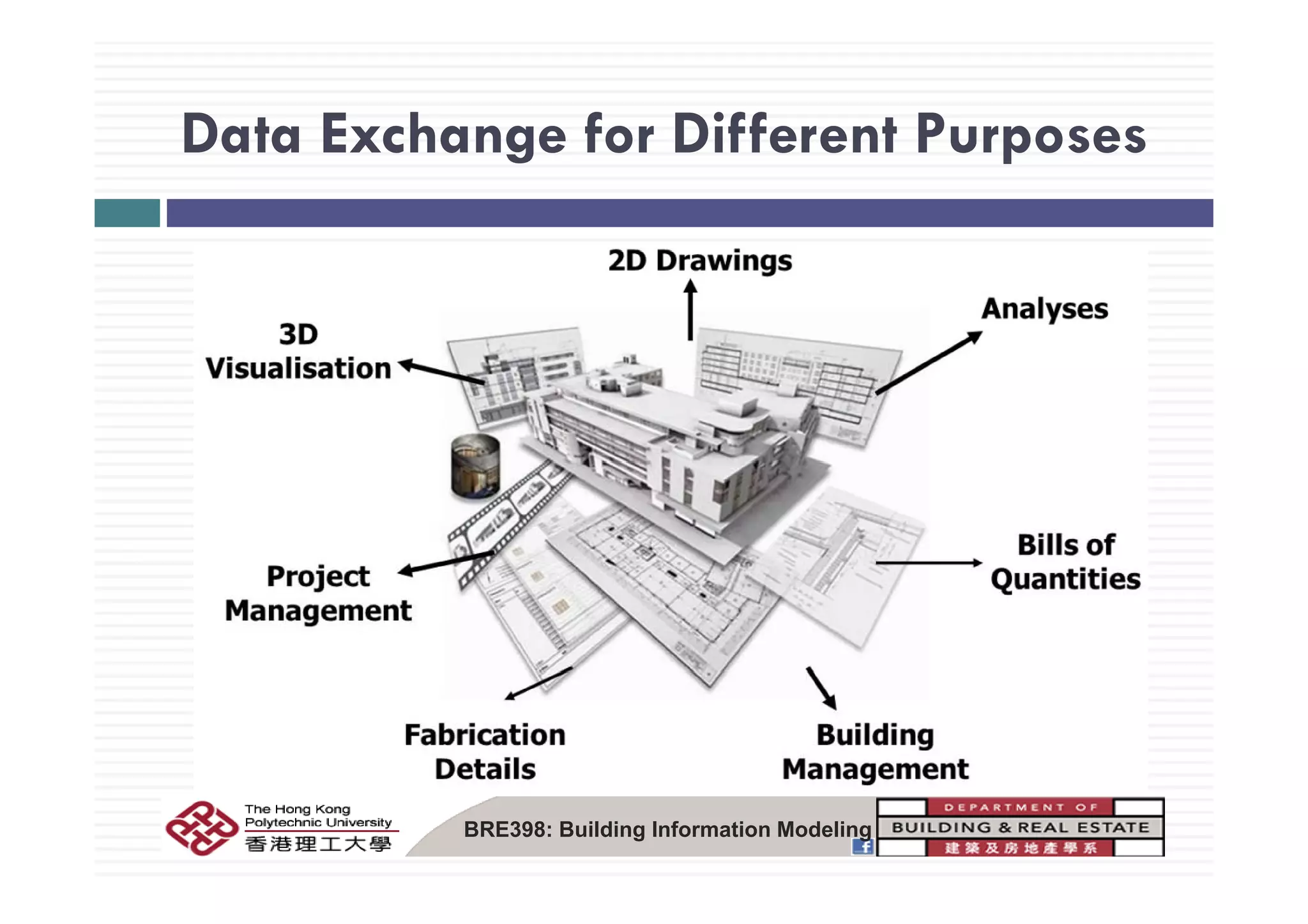

Data Exchange for Different PurposesData Exchange for Different Purposes
BRE398: Building Information Modeling

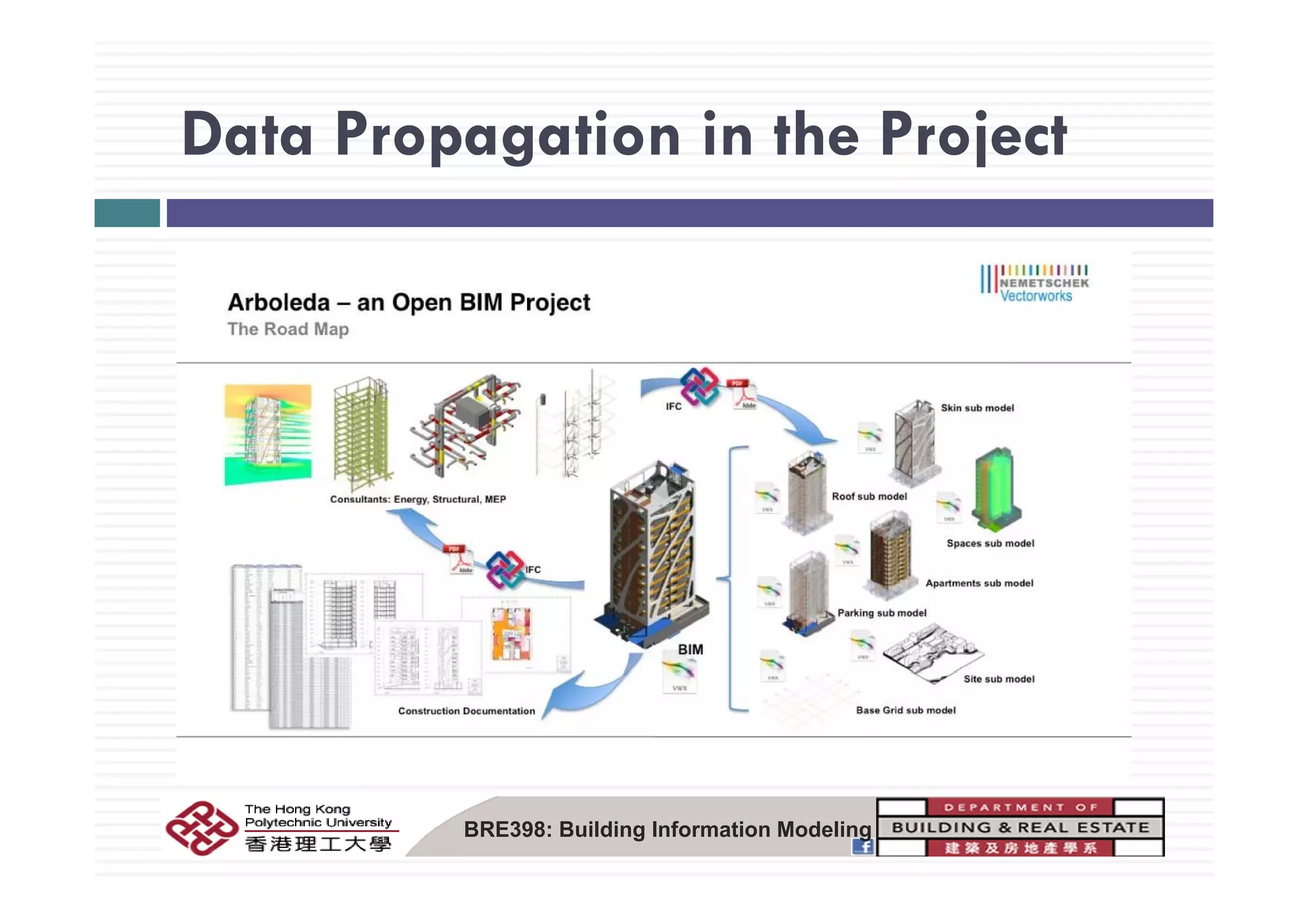

Data Propagation in the ProjectData Propagation in the Project
BRE398: Building Information Modeling

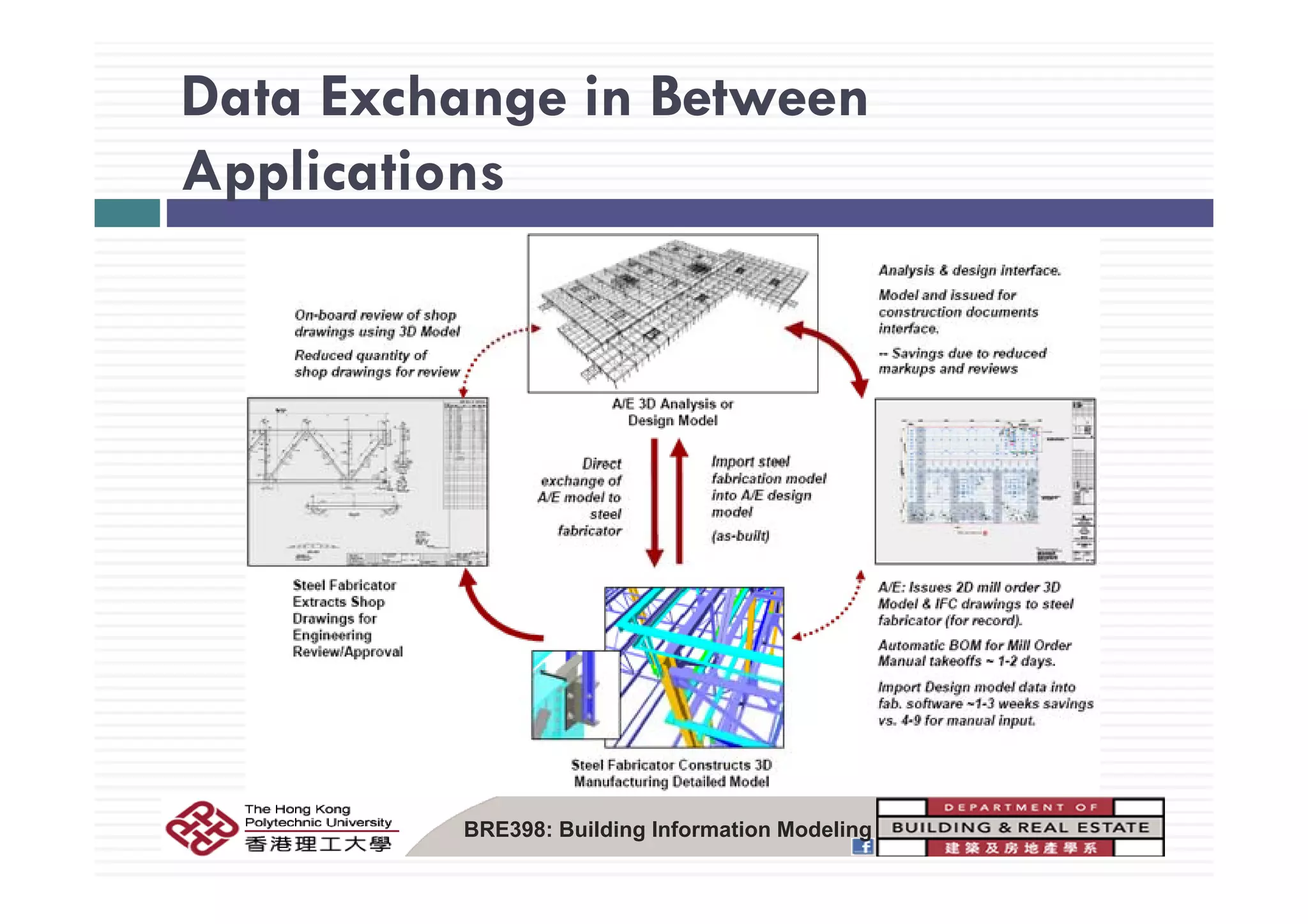

Data Exchange in Between
Applications
BRE398: Building Information Modeling
Data Exchange in Between SoftwaresData Exchange in Between Softwares
BRE398: Building Information Modeling

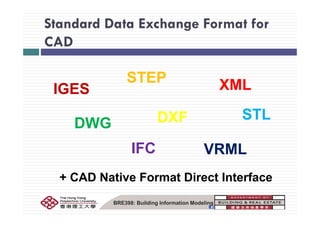

Standard Data Exchange Format for
CAD
IGES
STEP XMLIGES
DXF
XML
STL
DWG DXF STL
VRMLIFC
+ CAD Native Format Direct Interface
BRE398: Building Information Modeling

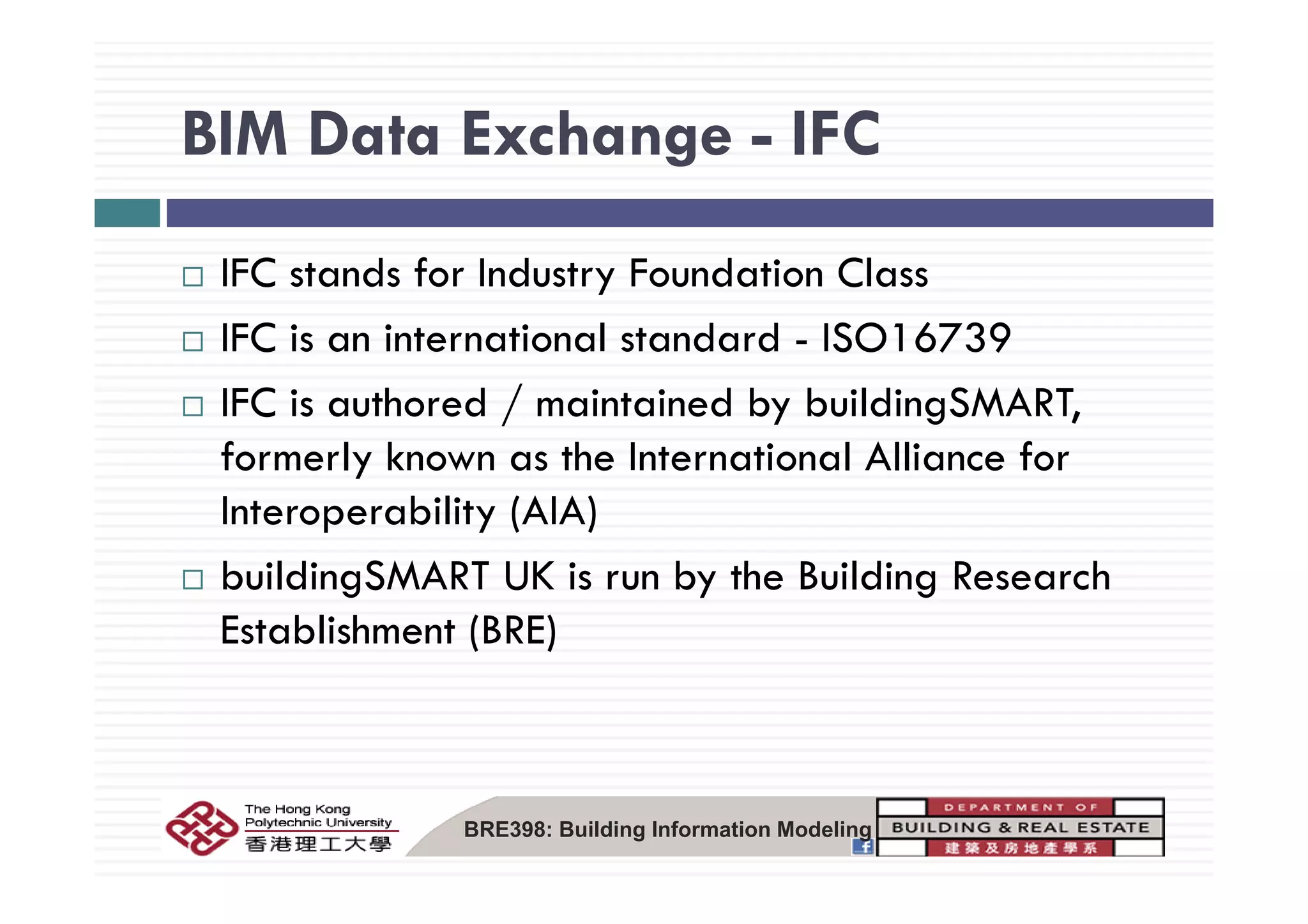

BIM Data Exchange - IFCBIM Data Exchange IFC
IFC stands for Industry Foundation Class
IFC is an international standard - ISO16739
IFC is authored / maintained by buildingSMART,
formerly known as the International Alliance forformerly known as the International Alliance for
Interoperability (AIA)
b ildi SMART UK i b th B ildi R hbuildingSMART UK is run by the Building Research
Establishment (BRE)
BRE398: Building Information Modeling

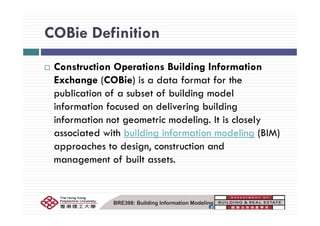

COBie DefinitionCOBie Definition
Construction Operations Building Information
Exchange (COBie) is a data format for the
publication of a subset of building model
information focused on delivering building
information not geometric modeling. It is closely
associated with building information modeling (BIM)
approaches to design, construction and
management of built assets.g
BRE398: Building Information Modeling

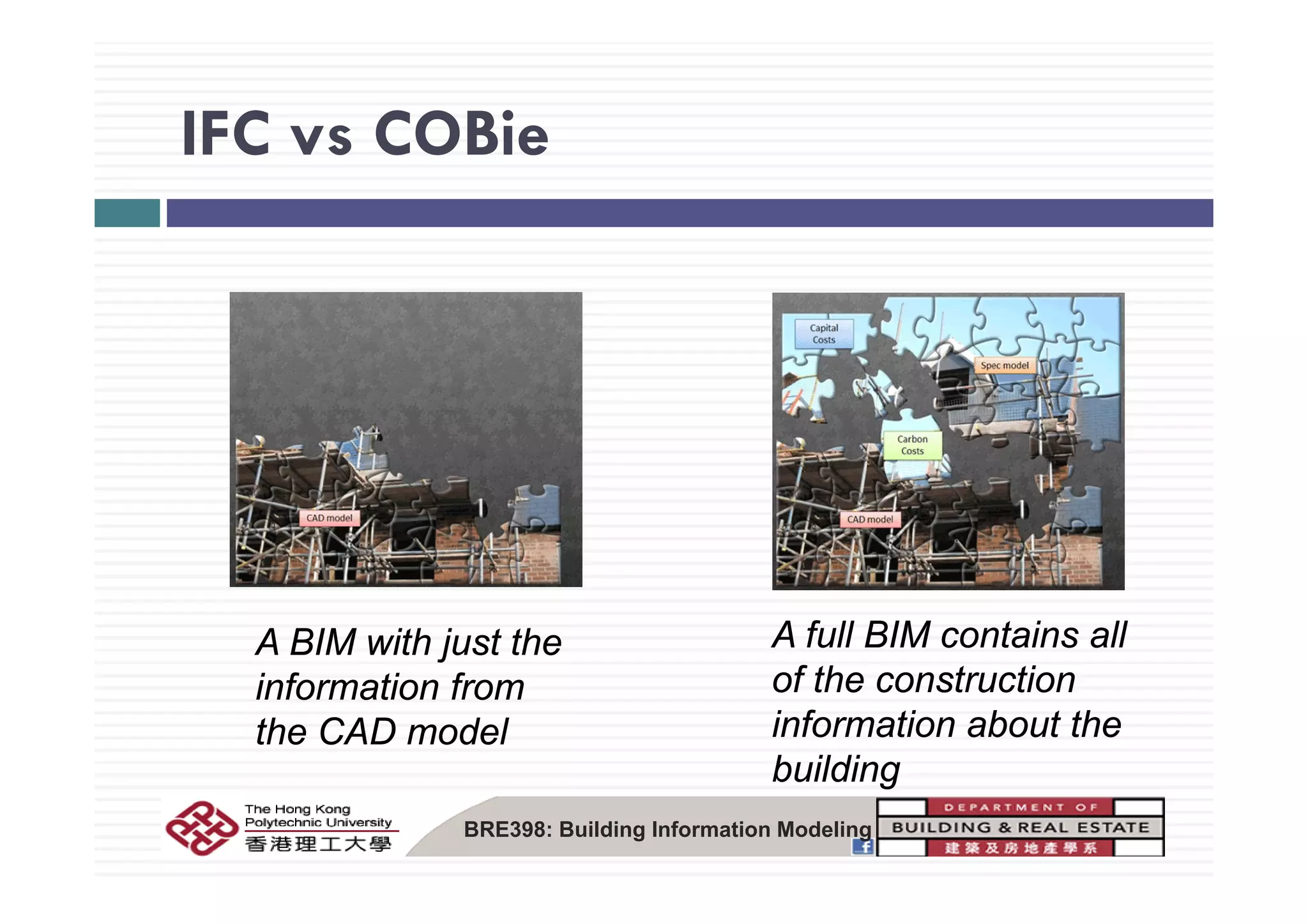

IFC vs COBieIFC vs COBie
A BIM with just the A full BIM contains all
f th t tiinformation from
the CAD model
of the construction
information about the
building
BRE398: Building Information Modeling
building

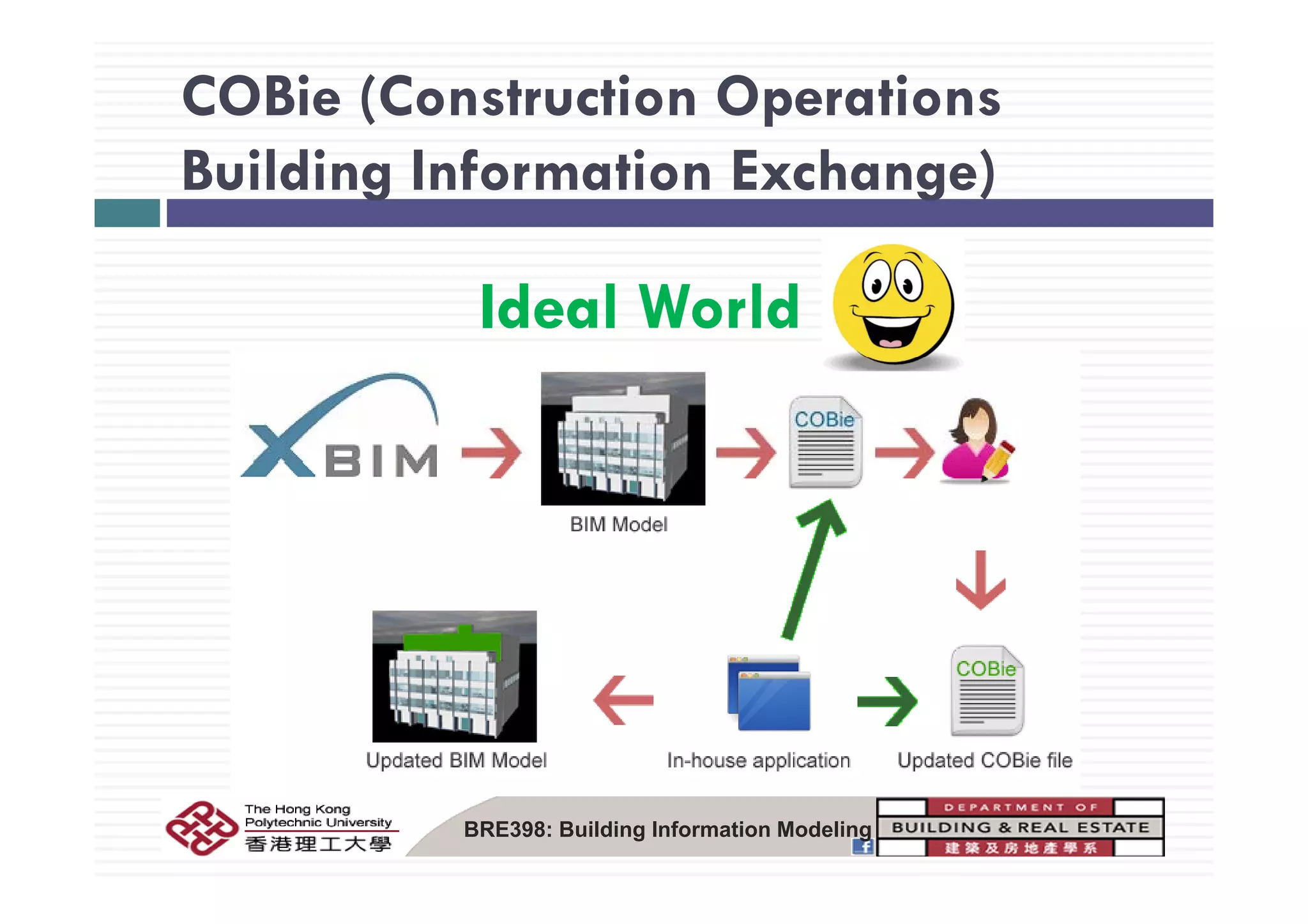

COBie (Construction Operations
Building Information Exchange)
Ideal World
BRE398: Building Information Modeling
COBie exchange to IFCCOBie exchange to IFC
M MThe xBIM Toolkit can allow a user to create a BIM
model in IFC format. xBIM performs validation on
th BIM d l d th t th l tthe BIM model, and then exports the relevant
information into COBie format.
Si COBi i i d h (h d bl )Since COBie is in a spreadsheet (human-readable)
format, a user can easily update the COBie file.
A d d COB h d b k hAn updated COBie is then imported back with
changes propagating to the IFC BIM model, and
b tl th IFC fil l b i t d i tsubsequently the IFC file can also be imported into
any proprietary software such as Autodesk Revit.
BRE398: Building Information Modeling
Real worldReal worldReal worldReal world
We cannot avoid data lostWe cannot avoid data lost
for CAD data exchange infor CAD data exchange in
between different software !between different software !between different software !between different software !
Even within the same software…..
BRE398: Building Information Modeling

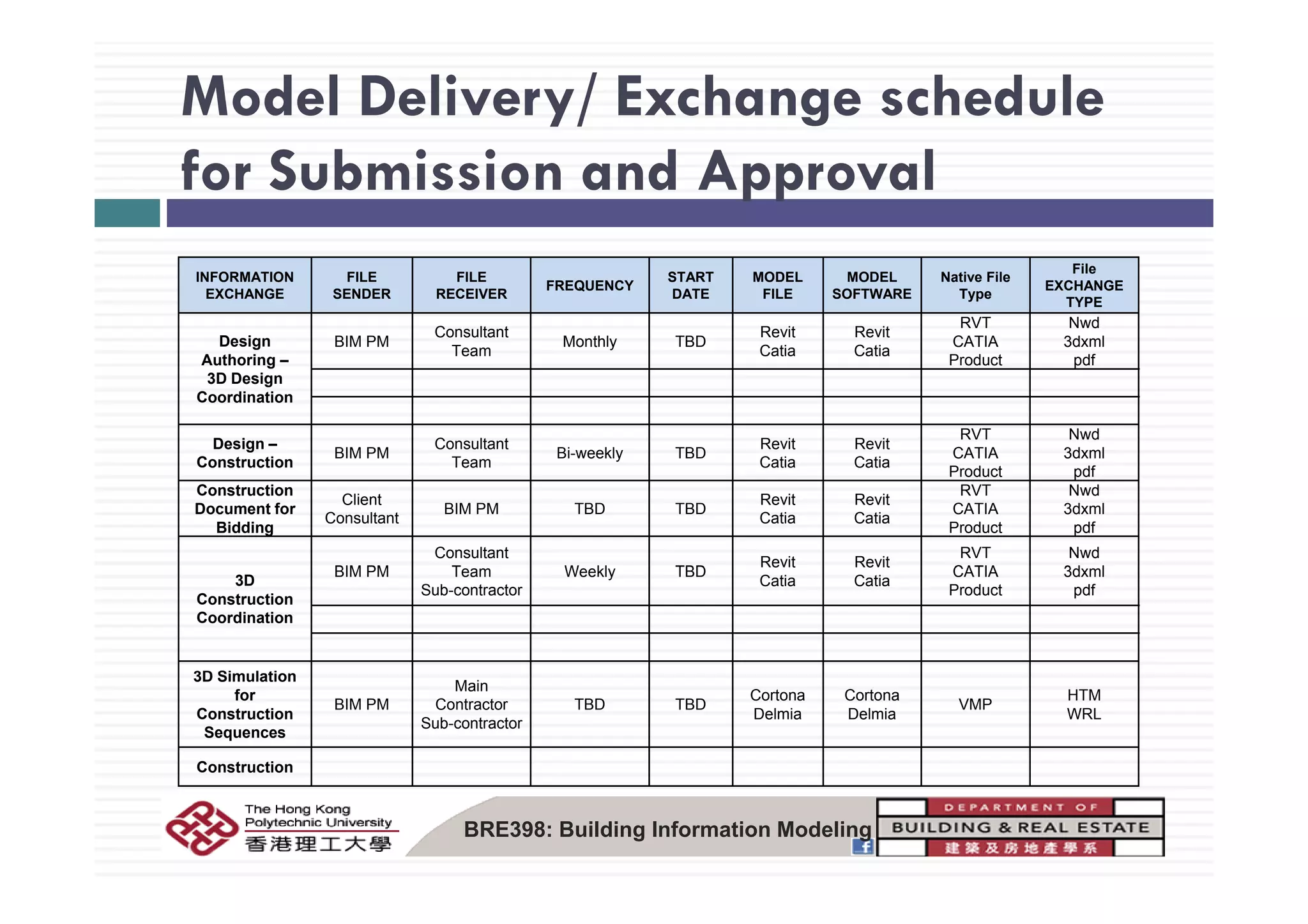

Model Delivery/ Exchange schedule
for Submission and Approval
INFORMATION
EXCHANGE
FILE
SENDER
FILE
RECEIVER
FREQUENCY
START
DATE
MODEL
FILE
MODEL
SOFTWARE
Native File
Type
File
EXCHANGE
TYPE
Design
A thoring
BIM PM
Consultant
Team
Monthly TBD
Revit
Catia
Revit
Catia
RVT
CATIA
Prod ct
Nwd
3dxml
pdfAuthoring –
3D Design
Coordination
Product pdf
Design –
Construction
BIM PM
Consultant
Team
Bi-weekly TBD
Revit
Catia
Revit
Catia
RVT
CATIA
Nwd
3dxml
Construction Team Catia Catia
Product pdf
Construction
Document for
Bidding
Client
Consultant
BIM PM TBD TBD
Revit
Catia
Revit
Catia
RVT
CATIA
Product
Nwd
3dxml
pdf
BIM PM
Consultant
T W kl TBD
Revit Revit
RVT
CATIA
Nwd
3d l
3D
Construction
Coordination
BIM PM Team
Sub-contractor
Weekly TBD
Revit
Catia
Revit
Catia
CATIA
Product
3dxml
pdf
3D Si l ti3D Simulation
for
Construction
Sequences
BIM PM
Main
Contractor
Sub-contractor
TBD TBD
Cortona
Delmia
Cortona
Delmia
VMP
HTM
WRL
Construction
BRE398: Building Information Modeling
TopicsTopics
BIM Project Execution Plan
Project Organization Structurej g
BIM Data Model Structure
P j t I l t ti P & C i tiProject Implementation Process & Communication
Quality & Risk Management
BRE398: Building Information Modeling

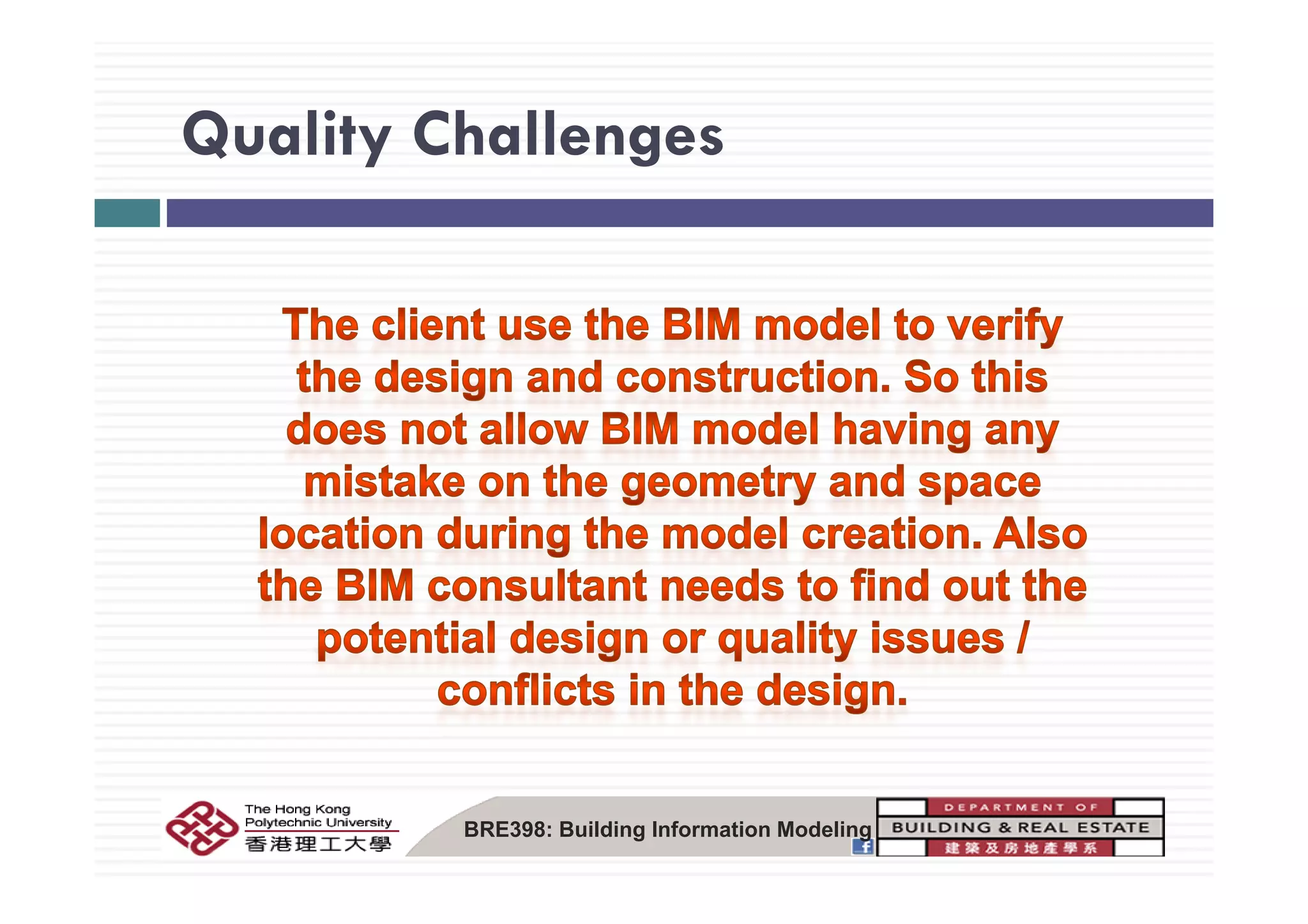

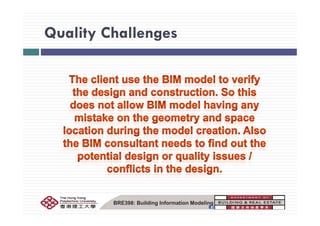

Quality ChallengesQuality Challenges
BRE398: Building Information Modeling
Quality ManagementQuality Management
I d t d l lit i j t h t lIn order to assure model quality in every project phase, control
procedures need to be set in place.
Each of the models created during project progression and
d l d b l d d d ldevelopment needs to be pre-planned considering model content,
level of detail, format and responsible party for updates, quality
and distribution of the model to all the parties involved in the
di ti ff tcoordination efforts.
Each of the parties contributing to the BIM model should have a
responsible person or Model Manager to handle the model.
Model Managers, as part of the core BIM team, are in charge of
participating in design reviews and coordination sessions along with
taking care of all the issues that might arise with keeping the model
updated, accurate and comprehensive.
BRE398: Building Information Modeling

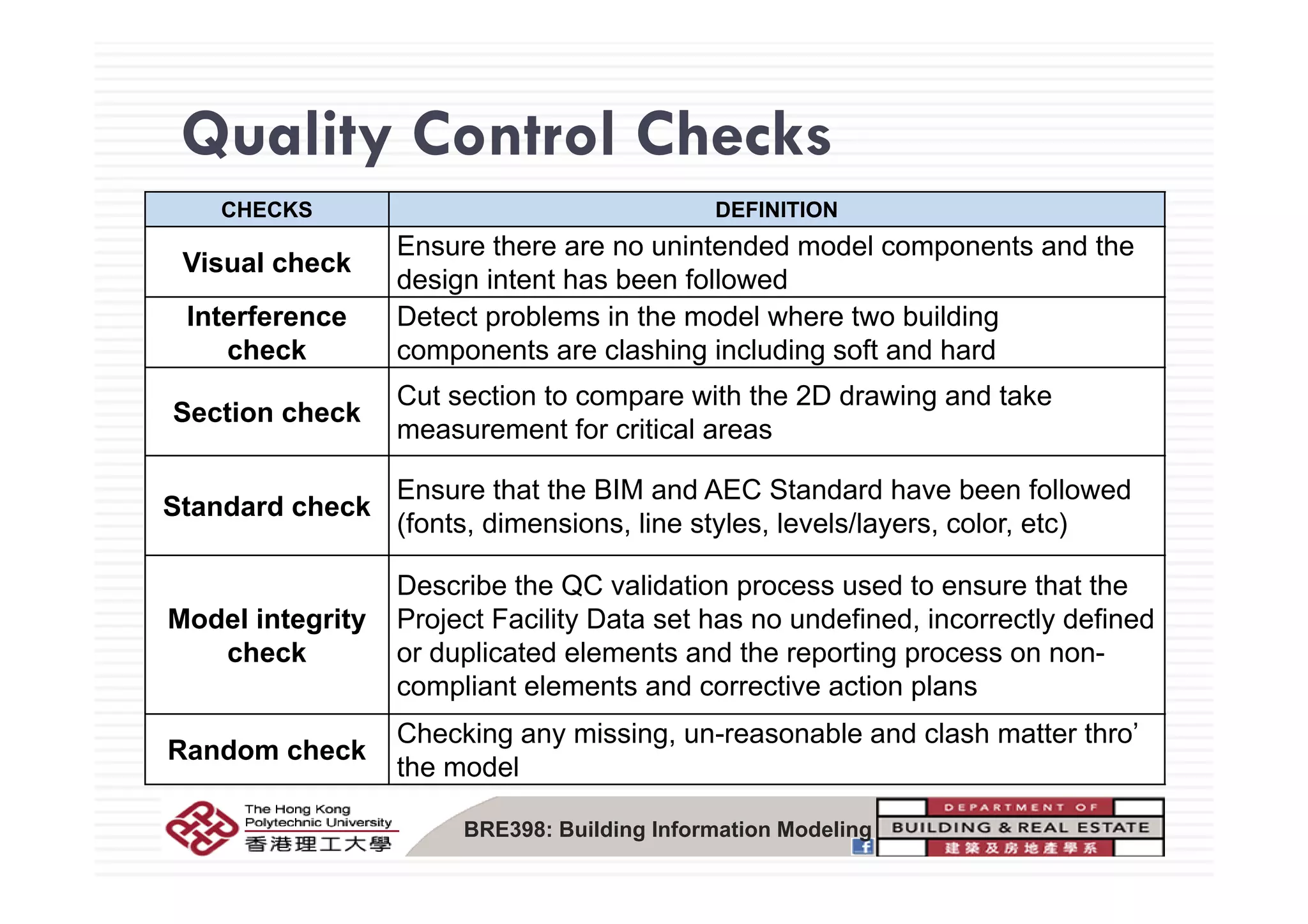

Quality Control ChecksQuality Control Checks
CHECKS DEFINITION
Vi l h k
Ensure there are no unintended model components and the
Visual check
Ensure there are no unintended model components and the
design intent has been followed
Interference
check
Detect problems in the model where two building
components are clashing including soft and hardcheck components are clashing including soft and hard
Section check
Cut section to compare with the 2D drawing and take
measurement for critical areas
Standard check
Ensure that the BIM and AEC Standard have been followed
(fonts, dimensions, line styles, levels/layers, color, etc)
Model integrity
check
Describe the QC validation process used to ensure that the
Project Facility Data set has no undefined, incorrectly defined
or duplicated elements and the reporting process on non-
compliant elements and corrective action plans
Random check
Checking any missing, un-reasonable and clash matter thro’
the model
BRE398: Building Information Modeling
t e ode

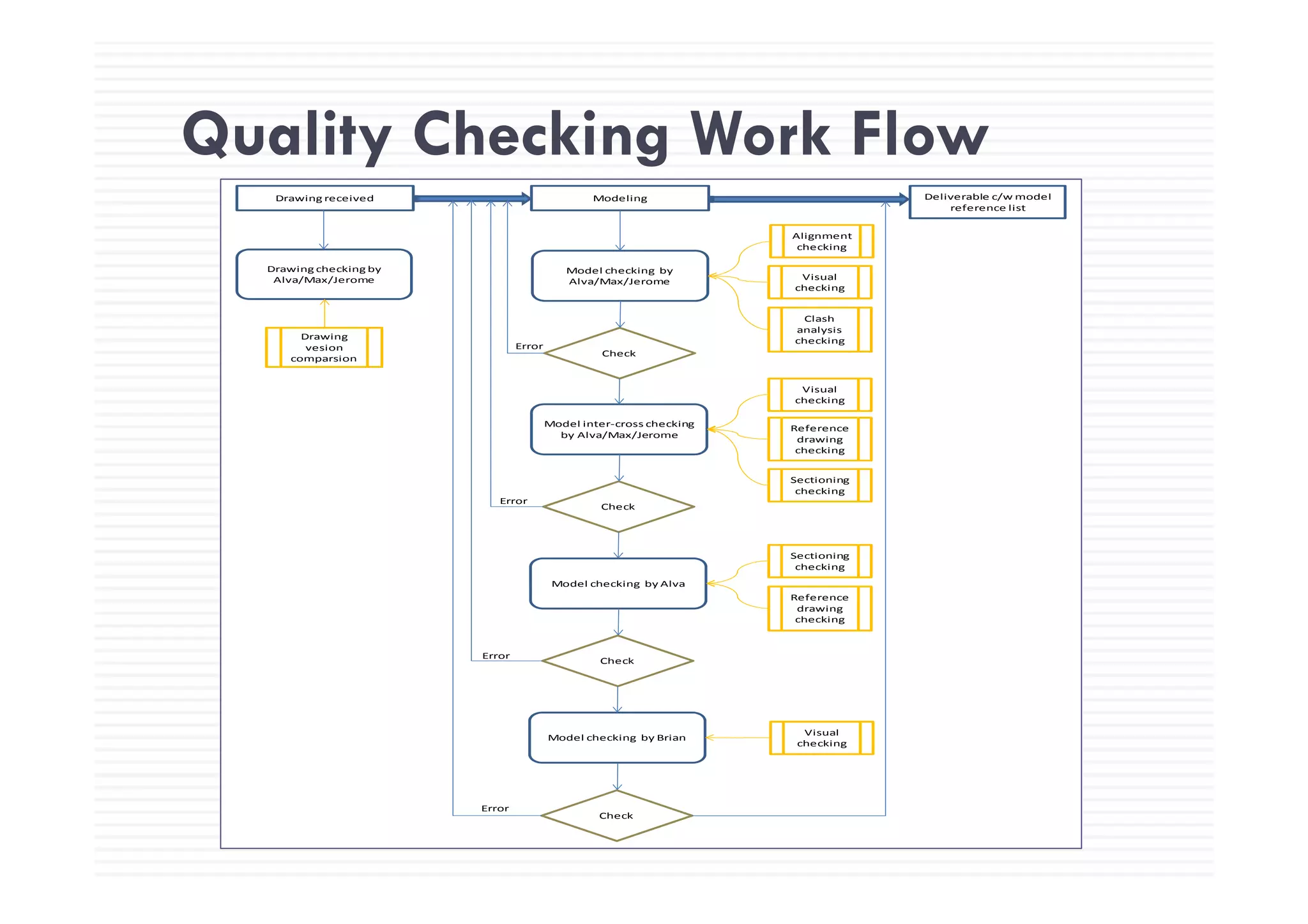

Quality Checking Work FlowQuality Checking Work Flow
Drawing received Modeling Deliverable c/w model
reference list
Alignment
checking
Drawing checking by
Alva/Max/Jerome
Model checking  by
Alva/Max/Jerome  Visual
checking
Check
Clash
analysis
checkingDrawing
vesion
i
Error
Model inter‐cross checking
by Alva/Max/Jerome
Reference
drawing
checking
Visual
checking
comparsion
Sectioning
checking
Check
Sectioning
checking
Error
Model checking  by Alva
Check
checking
Reference
drawing
checking
Error
Model checking  by Brian
Visual
checking
Error
Check

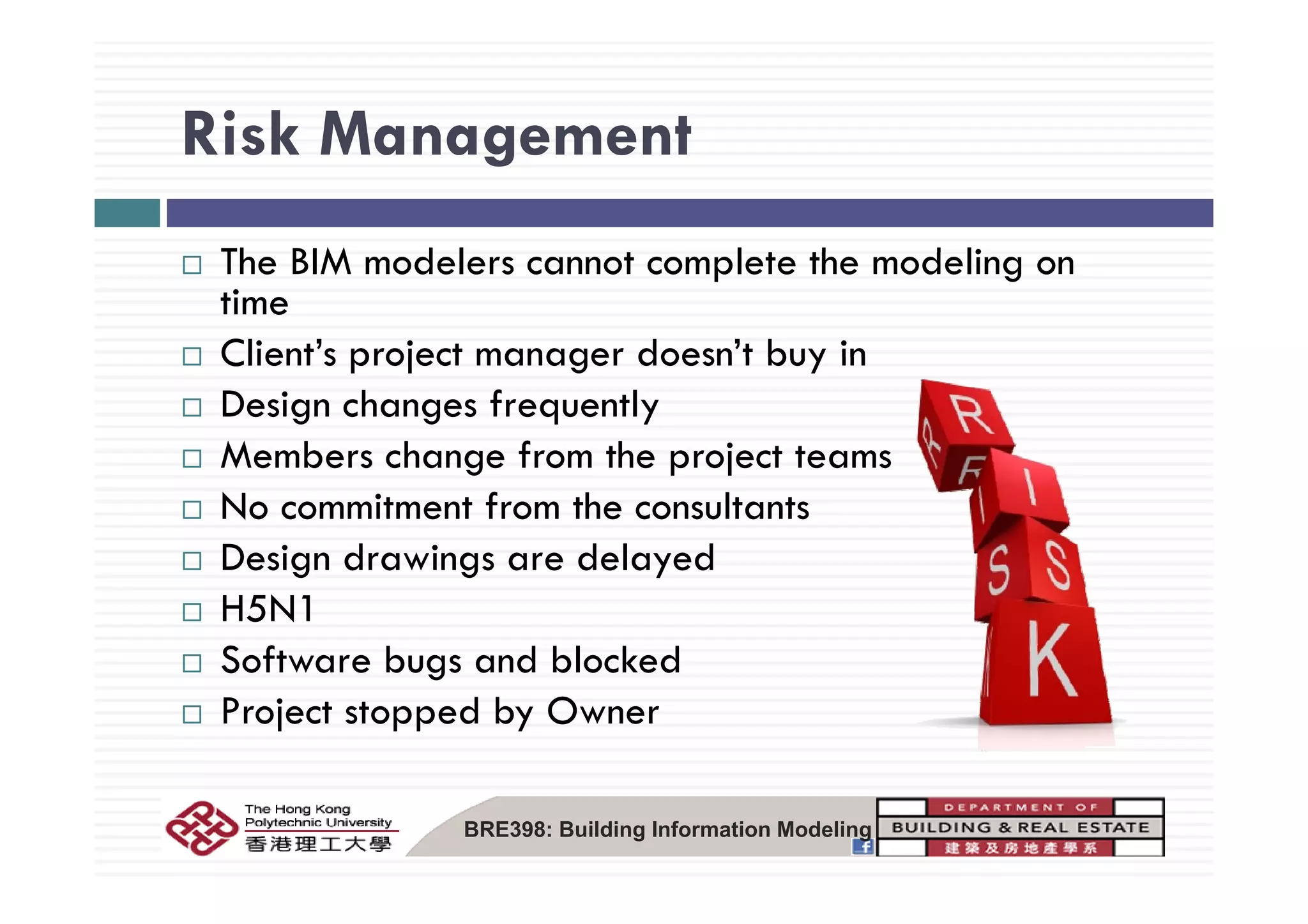

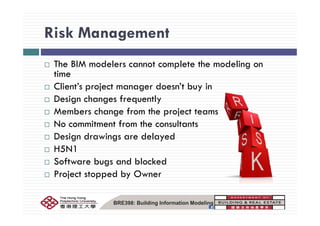

Risk ManagementRisk Management
Th BIM d l t l t th d liThe BIM modelers cannot complete the modeling on
time
Client’s project manager doesn’t buy inClient s project manager doesn t buy in
Design changes frequently
Members change from the project teamsMembers change from the project teams
No commitment from the consultants
Design drawings are delayedDesign drawings are delayed
H5N1
Software bugs and blockedSoftware bugs and blocked
Project stopped by Owner
BRE398: Building Information Modeling

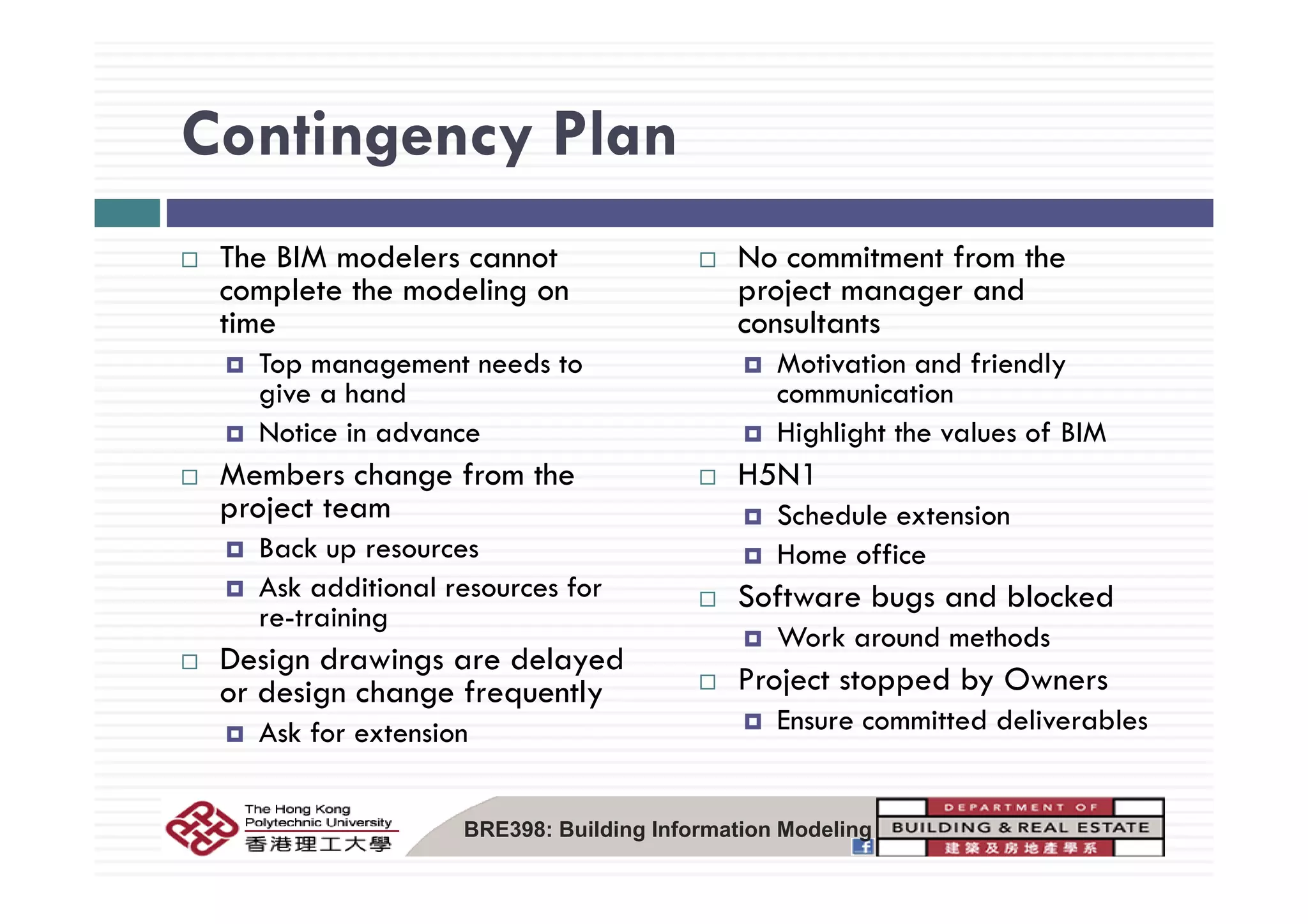

Contingency PlanContingency Plan
Th BIM d l t N it t f thThe BIM modelers cannot
complete the modeling on
time
T t d t
No commitment from the
project manager and
consultants
M ti ti d f i dlTop management needs to
give a hand
Notice in advance
Motivation and friendly
communication
Highlight the values of BIM
Members change from the
project team
Back up resources
H5N1
Schedule extension
Home office
Ask additional resources for
re-training
Design drawings are delayed
Software bugs and blocked
Work around methods
P j d b O
g g y
or design change frequently
Ask for extension
Project stopped by Owners
Ensure committed deliverables
BRE398: Building Information Modeling
Questions & Answers
stephenau@mtech.com.hk
BRE398: Building Information ModelingBRE398: Building Information Modeling

BIM project execution

  • 1.
    BIM Project ExecutionBIMProject Execution Stephen AUStephen AU Oct. 17, 2013 Lecture Class BRE398: Building Information Modeling BRE398: Building Information Modeling
  • 2.
    TopicsTopics BIM Project ExecutionPlan Project Organization Structurej g BIM Data Model Structure P j t I l t ti P & C i tiProject Implementation Process & Communication Quality & Risk Management BRE398: Building Information Modeling
  • 3.
    Lecture Objectives andResultsLecture Objectives and Results Objectives To understand how BIM project is implemented and its challenges Question How to execute a successful BIM project? BRE398: Building Information Modeling
  • 4.
    TopicsTopics BIM Project ExecutionPlan Project Organization Structurej g BIM Data Model Structure P j t I l t ti P & C i tiProject Implementation Process & Communication Quality & Risk Management BRE398: Building Information Modeling
  • 5.
    BIM Business ModelBIMBusiness Model lProperty Developer Employ an independent BIM consultant to create the As- Design As Construct and As Build BIM model for design &Design, As-Construct and As-Build BIM model for design & construction verification Architect / Structure / MEP ConsultantArchitect / Structure / MEP Consultant Use in house BIM team to build the As-Design model for design verification Main Contractor / Specialised Sub-Contractor Either employ an independent BIM consultant or by in house BIM team to do the As-Construction BIM model to reduce the construction errors and delivery time BRE398: Building Information Modeling
  • 6.
    BIM Benefits vsLeadershipBIM Benefits vs Leadership Ref: http://changeagents.blogs.com/thinkspace/ BRE398: Building Information Modeling e ttp //c a geage ts b ogs co /t space/
  • 7.
    Objective of BIMProject Execution Plan To successfully implement Building Information Modelling (BIM) on a project, the project team has to develop a MBIM Project Execution Plan. The BIM Project Execution Plan defines uses for BIM on the building construction project from design, engineering, construction to facility management, along with a collaboration process for executing BIM on the project. The goal of the BIM Project Execution Plan is to manage and control the quality of the BIM deliverables BRE398: Building Information Modeling
  • 8.
    BIM Project ExecutionPlan Blue PrintBIM Project Execution Plan Blue Print Ref: http://changeagents.blogs.com/thinkspace/
  • 9.
    Quality for BIMProjectQuality for BIM Project Q lit ti t ’ ( d) i t f lQuality means meeting customers’ (agreed) requirements, formal and informal, at lowest cost, first time every time. To success, we should understand the current and future customer d h ld d dneeds, should meet customer requirements and strive to exceed customer expectations. We should create and maintain an internal environment in which people can become fully involved in achieving the project’s objectives. A desired result is achieved more efficiently when activities and related resources are managed as a process. So identifying, understanding and managing interrelated processes as a system are required. Further continual improvement of the overall performance should be a permanent objective of the organization. BRE398: Building Information Modeling
  • 10.
    PDCAPDCA PLAN l df b dPLAN: Develop product specifications based on customer needs. Develop performance measures and the means to check themthe means to check them. DO: Design the processes that will produce the products and services Work the processes and collectproducts and services. Work the processes and collect quality, service, and management data. CHECK: Develop variances of actual performance toCHECK: Develop variances of actual performance to plan and develop improvement initiatives to correct deficiencies. ACT: Implement the process improvement program and incorporate new technologies as appropriate. BRE398: Building Information Modeling
  • 11.
    Project ScopeProject Scope Typeof building Design briefingg g Areas Ti t d liTime to delivery Budget Stakeholders …..….. BRE398: Building Information Modeling
  • 12.
    BIM Project MissionBIMProject Mission D fi th j t t t t d if h thDefine the project statement and specify how the implementation of BIM technologies and processes enhances that performance of building construction project. Project Mission Statement e.g. To minimize the construction risk due to the 1st mega project buildingg g p j g in China, that the developer project team has to collaborate with local construction team. BIM Enhancement Mission F A d i BIM t t C t ti BIM ith ite.g. From As-design BIM propagate to Construction BIM with on site engineer support BRE398: Building Information Modeling
  • 13.
    Project ObjectivesProject Objectives BIMGoal Measureable Objective Achieved If (measurable KPI) Projected Timeframe I i ibilit f d i f ll t k h ld P d hit t BIM Th d l i d b th M h 2010Improve visibility of design for all stakeholders Produce architecture BIM model for DC and BP submission The model is approved by the architect and developer March 2010 – January 2011 Prepare BIM model to be transferred between project stakeholders to minimize duplication of effort Conduct conflict resolution analysis during design to eliminate design clashes, resulting in a well-coordinated model prior to construction Utilize model for 3D Design Reviews to assist with equipment clearances and owner design decisionsg Conduct coordination review of key systems with construction manager and specialty trade contractors during construction Develop an accurate Record Model and As-Built Model to be used for integration into facility management system(s) within the traditionalintegration into facility management system(s) within the traditional standard of care provisions that govern the design and construction of the project. Model should include and/or link all approved submittals, shop drawings, O&M Manuals, building control drawings, construction photos, inspection reports, and commissioning data as required BRE398: Building Information Modeling Prepare accurate design documents and construction documents derived from the model to establish basis of design within the traditional standard of care provisions that govern the design of the project
  • 14.
    Purposes of theBIM ModelPurposes of the BIM Model E bli h i l i i f i i l hi l dEstablish a single primary repository for critical architectural geometry and information Facilitate rapid design changes that are automatically reflected in the ancillary ddocuments Provide automatically coordinated drawings to the architects Facilitate full 3D modeling of structure by the structural engineerg y g Eliminate conflicts that typically arise with the integration of MEP Allow automated reporting of certain quantities for the QS Provide an easily accessible source of accurate information for tendering Provide a constructionally accurate rendering model Allow contractors to visualize construction sequencing and anticipate possibleAllow contractors to visualize construction sequencing and anticipate possible delays Become the basis for facilities management work after construction BRE398: Building Information Modeling
  • 15.
    Purposes of theBIM ModelPurposes of the BIM Model B tt d i t l th h b tt t di ti &Better design control through better team coordination & collaboration Single database of integrated informationSingle database of integrated information Project seen as process ecosystem Risk reduction (lack of claims ) Reduction of Change Orders on site (lower rate on projects for non-scope items) C T ki (b i i d i h d iCost Tracking (better estimating during the design process – quantities) Better Coordination of 2D Drawings generated fromBetter Coordination of 2D Drawings generated from resolved 3D Model 3D Information exchange with consultants and fabricators BRE398: Building Information Modeling
  • 16.
    BIM DeliverablesBIM Deliverables BRE398:Building Information Modeling
  • 17.
    Models, Content andAuthoring ToolsModels, Content and Authoring Tools Model Name Model Content Project Stage Authoring Tool Architectural Massing Model Building massing studies with indicative dimensions, area, volume, location, and orientation. Conceptual Design Autodesk® Revit® Architecture Rhino Catia V5 R20 Architectural Model As per Singapore BIM Guide Appendix B. Preliminary Design and Detailed Design Autodesk® Revit® Architecture Catia V5 R20 Coordination Model Architectural, structural, and MEP components of main Detailed Design Autodesk® Navisworks Manage Catia 3dxml viewer and 3D PDFp building. Civil Model Structural Model MEP Model Curtain Wall / Facade Interior Design Construction Model A B ilt M d l BRE398: Building Information Modeling As-Built Model
  • 18.
    Analysis Services andTools (1/2)Analysis Services and Tools (1/2) Analysis Services Analysis Reports Project Stages Analysis Tool Design Review Review design development / progress and require feedback based Design Autodesk® Revit® Design Review g p p g q on design Design Architecture, Catia V5 Design Co-ordination Determine and resolve major system design conflicts prior to construction Design Autodesk® Navisworks Manage, Catia 3dxml viewer and 3D PDF Energy Conduct energy assessments for building design, inspect building energy standard compatibility, and optimize proposed design to reduce facility lifecycle costs Planning Design Structural Analyze model based on structural specifications Construction Autodesk® Revit® Architecture Catia V5Architecture, Catia V5 Interference Checking • A “hard” interference is where the geometry of the objects in question actually overlaps • A “soft” interference is where it is a predefined clearance between objects that is in question Design and construction Autodesk® Revit® Architecture, Catia V5 • A “programmed” interference is where the software being used allows the user to pre-program variable interference requirements based on a set of rules and object types. Spatial Analysis Assess design performance in regards to spatial requirements ie analyse space and understand complexity of space standards and Design and construction Autodesk® Navisworks Manage Catia 3dxmlSpatial Analysis analyse space and understand complexity of space standards and regulations. construction Manage, Catia 3dxml viewer and 3D PDF Scheduling/4D Linking 3D model elements with a construction programme enabling real time visualisation of build sequence. Autodesk® Revit® Architecture, Catia V5 Generate accurate quantity take-offs and cost estimates. Providing Cost Analysis/5D Generate accurate quantity take offs and cost estimates. Providing ‘what if’ analysis capabilities to assess modifications to design or programme.
  • 19.
    Analysis Services andTools (2/2)Analysis Services and Tools (2/2) Model Name Model Content Project Stage Authoring Tool Daylight/Lighting Analyze lighting systems based on design specifications Planning Design 3D Animation Use of visualisation technologies to develop high quality renders and animations. Provide life-like experience and show the major building equipment space clearance reservations Design Cortona3D equipment space clearance reservations. Knowledge base engineering Analyze spatial program and requirements and accurately assess design performance in regard to space standards and regulations Planning Design Safety Analyse the safety measure and risk potential on the site work environment Construction Cortona3D Construction Method Statement Demonstrate the working sequences before the physical work start Construction Cortona3D Site Analysis Evaluate site to determine if site meets the required criteria according to project requirements, technical factors and/or financial factors Planning Integration of 3D models with Rapid Prototyping processes to create Rapid Prototyping Integration of 3D models with Rapid Prototyping processes to create and test physical models under controlled conditions eg wind tunnel testing. Digital M f t i Considering opportunities for future fabrication, i.e. communicating information in a format that enables prefabrication of objects directly Manufacturing from a 3D model.
  • 20.
    BIM Maturity ModelBIMMaturity Model Ref: NBIMS CMM Chart (download the MS Excel file from http://bit ly/NBIMS)Ref: NBIMS CMM Chart (download the MS Excel file from http://bit.ly/NBIMS) - See more at: http://www.bimthinkspace.com/2009/09/episode-12-bim- performance-measurement.html#.dpuf
  • 21.
    Project ScheduleProject Schedule Thh d l t b t h d ith th d i t tiThe schedule must be matched with the design construction master plan and be flexible. W k d i ti Design stage Construction stage 2013 2014 2015 2016 2017 2018 2019 5 6 7 8 9 10 11 12 1 4 7 10 1 4 7 10 1 4 7 10 1 4 7 10 1 4 7 10 1 4 7 10 Modeling works Underground B2 Works description 2013 2014 2015 2016 2017 2018 2019 B2 B1 G/F 1/F 2/F2/F 3/F 5/F 6/F Tower 3-11 (high-rise building)Tower 3 11 (high rise building) Tower L1-L9 (low-rise building) Clash review and design review Site co-ordination As-built model BRE398: Building Information Modeling
  • 22.
    Resources PlanningResources Planning PersonalProductivity Unit (PPU) Time to build one floor of XX sq. m BIM model for structural design. Architect design, MEP design etc. Time to output the deliverables to client (BT)p ( ) No. of Modeler (NM) required for a required floor area for a specific discipline say: Structural Designarea for a specific discipline, say: Structural Design is NM = BT / PPUNM = BT / PPU BRE398: Building Information Modeling
  • 23.
    TopicsTopics BIM Project ExecutionPlan Project Organization Structurej g BIM Data Model Structure P j t I l t ti P & C i tiProject Implementation Process & Communication Quality & Risk Management BRE398: Building Information Modeling
  • 24.
    Participation PartiesParticipation Parties PropertiesOwner Architect Structural Engineering MEP C lt tMEP Consultants Quantity Surveyor Interior Design Local Design Institute (for China Project)Local Design Institute (for China Project) …… BRE398: Building Information Modeling
  • 25.
    BIM Project TeamOrganization Developer BIM Consultant BIM Project Team Organization Developer BIM Consultant • Experience C dibl • Project Management • Experience with oject gement • Credible • Co-ordination with MTECH Team Project Manager Experience with Industrial application • Facilitates co- ordination with Client Team Client Manager Technical Pro Manag Project Manager Technical Manager / Project Leader Key FunctionalTechnical Architectural 3D Modeler • Design errors checking • 3D Modeling Design change updateKey Functional RepsKey Functional RepsKey Consultant Reps Technical TeamTechnical TeamClient Project Team ojectTeam Structure 3D Modeler MEP 3D Modeler • Design change update • Reporting • Deliverables demonstration • Support of client Pro • Current project knowledge • Respected by peers • Functional • Respected by peers • Empowered I/T Infrastructure Support
  • 26.
    Project Team StructureProjectTeam Structure BIM Consultant Client Manager Owner Project Director Owner Project Manager BIM Project Manager Project Leaders /Model Manager BIM Methodology & Process Consultant Design consultants Architect Structure/Model Manager Trainer Structure MEP Local Design Institute Other design consultants… Design Team A Modoler 1, Modoler 2 Modoler 3, Modoler 4 Modoler 5 , Modoler 6 BIM Team Leader Lead Designer A TEAM A Remark: The team can be separated by building zone and /or by Design Team B Modoler 1, Modoler 2 Modoler 3, Modoler 4 BIM Team Leader Lead Designer B TEAM B disciplines: arch, structure, civil, HVAC, drainage, electrical, fire,…. Modoler 5 , Modoler 6
  • 27.
    Project Team RelationshipProjectTeam Relationship Architect Developer 3D Master Main Constructor InboxOutbox ModelStructure Consultant Structure sub- contractor •Participants ibl f MEP Consultant Mullion sub-contractor responsible for providing geometry in 2D for BIM team to build the BIM model Other Consultants BIM Consultants BRE398: Building Information Modeling Other sub-contractors
  • 28.
    Role of BIMSupport Team Methodology & Process consultantProject Manager Role of BIM Support Team Methodology & Process consultant • Technical analysis & development • Define modeling methodology • Best practices development Project Manager • External communication & management • 3D modeling management • Monitor overall process & deliverables • Software training to the BIM modeler and users • Advanced training and technical support • MTECH resource planning BIM Modelers Team Leader • Project schedule / resource planning & monitoring • Architectural & structural design analysis • BIM model creation by disciplines • General Issue report • Checking the model integrity Architectural & structural design analysis • Define & manage outputs of BIM e.g. Quantitative export, Design co-ordination, etc. • Daily technical support to Arch / Structural modeling team BIM Model co-ordinator • Monitoring overall deliverables of modeling team Analysis of BIM modelmodeling team • Analysis of BIM model • Quality control for the BIM Model • Consolidate and release the Issue report to client BRE398: Building Information Modeling
  • 29.
    Skill ManagementSkill Management Idi t j t t b ’ t BIM kill b li ti lIndicate project team members’ current BIM skills by listing personnel type, number of employees of each type, and average skill level Personnel Type No. of Staff Average BIM Skill / Knowledge Levely g g Project Director 1 Novice BIM Manager 1 Average Project Leader 2 Average Modeller 1 Expert in Revit 5 Expert in CATIA Architecture Expert in CATIA MEP Rendering Engineer 2 Expert in 3dsmax E t i Vi t lExpert in Virtools Expert in Dreamweaver 3D Simulation Engineer 2 Expert in Cortona3D BRE398: Building Information Modeling
  • 30.
    Software Resources PlanningSoftwareResources Planning BIM Software 3D 2D Rendering SoftwareRendering Software Project Management Software Data Management & Process control Software MS Office ….. BRE398: Building Information Modeling 2013/10/17MTECH..............Confidential
  • 31.
    Hardware Resources PlanningHardwareResources Planning Design Office Graphic Workstationp Printer D t S d B kData Server and Backup Network BRE398: Building Information Modeling
  • 32.
    TopicsTopics BIM Project ExecutionPlan Project Organization Structurej g BIM Data Model Structure P j t I l t ti P & C i tiProject Implementation Process & Communication Quality & Risk Management BRE398: Building Information Modeling
  • 33.
    Model and DatabaseStructureModel and Database Structure P j N i C iProject Naming Conventions File Naming Conventions Field 1_Field 2_Field 3_Field 4_Field 5.xxxx Field 1: Project code, Field 2: Zone, Field 3: Trade, Field 4: Floor, Field 5: Type of servicesField 5: Type of services Example: ABC_POD_MEP_1F_VAC Numbering Conventionsg POD : Podium, TOW: Tower, FLR: Architectural, STR: Structural, MUL: Curtain wall, MEP: E&M, VAC: Air di i i d R f i i ELE El i l FSV Ficonditioning and Refrigeration, ELE: Electrical, FSV: Fire services, PLM: Plumbing, DRN: Drainage, TG: Town Gas BRE398: Building Information Modeling
  • 34.
    Model StructureModel Structure Thesuccess of a BIM enabled project delivery process is highly dependent upon the level atThe success of a BIM enabled project delivery process is highly dependent upon the level at which the entire project team can communicate and work collaboratively for the duration of the project. For buildings with a large footprint or multiple floors, the project team may split the model into l ( fl ) ith th di t dseveral zones (or floors) with the corresponding trades All trades will be modeled at the correct elevation All elements of the building must be represented in only one file and should be modeled by their specific trade. (For example, the architectural model provided for 3D Coordinationp ( p , p should not include any of the structural elements contained in the structural model. Lights should be modeled by the electrical engineer, not the architect) All 3D model files must strip extraneous 2D and/or 3D elements from the model before submission for clash detectionsubmission for clash detection The architectural ceilings should contain information of lights, diffuser, speaker, CCTV, etc. as required by design. (For example, lights are to be centered on a grid with proper spacing) All models should include separate 3D representations of required clearances and/or access i f i li h l h d bl Threquirements for equipment access, light clearances, overhead cable tray access, etc. These clearance/access models should be in a separate layer(s)/level(s) per each trade and labeled as such BRE398: Building Information Modeling
  • 35.
    Model Element Requirementsby Discipline S /C MOSITE/CIVIL MODEL ARCHITECTURAL MODEL STRUCTURAL MODEL MEP MODEL Mechanical Model Electrical Model Plumbing Model Fire Protection Model Drainage Model etc BRE398: Building Information Modeling
  • 36.
    Level of DevelopmentLevelof Development LOD 100 The model equivalent of conceptual design the model would consist of overallLOD 100 – The model equivalent of conceptual design, the model would consist of overall building massing and the downstream users are authorized to perform whole building types of analysis (volume, building orientation, cost per square foot, etc) LOD 200 – Model that includes basic elements including windows walls and doors. This level of d li i f i li ti d b i l i d i i il t th h ti d imodeling is for visualization and basic energy analysis and is similar to the schematic design or design development. It consists of generalized systems or assemblies with approximate quantities, size, shape, location, and orientation. LOD 300 – Model elements are suitable for construction and are the equivalent of traditional t ti d t d h d i Thi d l l l ld b it bl f l i dconstruction documents and shop drawings. This model level would be suitable for analysis and simulation of detailed elements and systems. LOD 400 – Model level of development considered suitable for fabrication and assembly. This model will include all as-constructed details for the CLIENT’s use to manage the facility. This is h i l f b il d i i h di i l ithe equivalent of as-built drawings in the traditional construction process. LOD 500 – The final level of detail represents the project as it has been constructed including property assets itemized with key parameters required by the CLIENT added to the model. All as-built record drawings and documentation at the time of turnover must be provided in the CAD f l f El l d d h d l b d l d b h h 2D d 3DCAD native file format. Elements included in the model must be detailed in both the 2D and 3D documentation for CLIENT use. Elements must be clearly marked or tagged and visual in both the 2D and 3D documentation. BRE398: Building Information Modeling
  • 37.
    Example of LODExampleof LOD Structure beam, column, slab and staircase Curtain wall/window wall Chilled water pump and valveFan coil unit, air duct and chilled water pipe
  • 38.
    Best Practice DevelopmentBestPractice Development 38 f d l / f l f l d lDefining model / file organization for large model assembly S d di i d li h d l f h / &Standardizing modeling methodology of arch / stru. & MEP modeling Predefined modeling procedure and skill set > ensurePredefined modeling procedure and skill set -> ensure stability and quality of model assembly Building up feature / knowledge driven modeling /Building up feature / knowledge driven modeling / catalog for reuse Structural (beams, columns)( , ) Architectural (doors, staircase, etc) MEP (VAV boxs, sprinklers) BRE398: Building Information Modeling
  • 39.
    TopicsTopics BIM Project ExecutionPlan Project Organization Structurej g BIM Data Model Structure P j t I l t ti P & C i tiProject Implementation Process & Communication Quality & Risk Management BRE398: Building Information Modeling
  • 40.
    Co-ordination of BIMto Design Process 3D d l t d i Revise in Design 3D model acts as design verification tools for issued 2D drawing I f d Design consultants next design DesignInformation extracted from 3D model feedbacks to improve d i d l t Design drawings Developer Logging / Issue design development Developer forms the central point of co- di i d i drawings Reportordination and monitors & manages the distribution / transfer of design information BIM Modeling team BIM model design information BRE398: Building Information Modeling
  • 41.
    Collaboration: Conceptual ViewCollaboration:Conceptual View Project Manager Architect Work Model Wo MEP orkSubmis Work BIM Master Model sions Work ModelQS Issued Master Archive Master Update Structural Work Model Master Model Model Review & Approval QS Work 3D Coordinator Inbox Architect Approval Work Model
  • 42.
    Operation FlowOperation Flow BIMModel & Reportsode & epo s OwnerArchitect Structural Eng. Subm MEP Eng. itDraw BIM Team Others wings MTECH ENGINEERING CO LTD - Page
  • 43.
    Project Design Phasing MasterLayout Plan Submission Drawing Design consultants BIM Modeling Team Project Design Phasing Individual Building Submission y Drawing Extended Preliminary Design Submission Drawing Arch. dwg. Structural dwg. MEP dwg. BIM ModelingModeling Construction Drawing Submission Drawing g Tendering 1st Issue BIM Model Consent & Construction Nth Issue BIM Model
  • 44.
    Typical BIM ModelingWorkflow Input of architectural / structural / MEP dwg. Typical BIM Modeling Workflow Drawing analysis and define modeling content Revised design Define modeling methodology (to comply output requirement of BIM) Design co-ordination Modeling schedule / resource planning / task assignment to modeling team M d li / i d d li Issue report to Inform consultant Modeling / revised modeling of BIM Identify modeling errors Identify design errors Developer / Consultants Review and check BIM Model Define scope / process of BIM output with consultants design errors e.g. quantity & attribute take-off, 2D drawing production Export BIM relevant information
  • 45.
    Coordination and ConflictResolutionCoordination and Conflict Resolution When conflicts are discovered in the model, regardless of project phase or LOD, the discovering party shall promptly notify the Model Element Author. Upon notification, the Model Element Author shall act promptly to mitigate the conflict. All project stakeholders and responsible parties must post their models to the designated shared server on a weekly basis as specified.y p BRE398: Building Information Modeling
  • 46.
    Design Collaboration (1/3)DesignCollaboration (1/3) Design error checking by clash detection among building components Cl h Arch. dwg. Clash detect Structural dwg. MEP dwg. Clash detection and reporting 3D 2D dwg modeling Modeler CATIA V5 BIM 2D dwg. cleaning
  • 47.
    3D Co-ordinated M&EModel3D Co ordinated M&E Model Direct and automatic detection of design errorDirect and automatic detection of design errorDirect and automatic detection of design errorDirect and automatic detection of design error
  • 48.
    Design Collaboration (2/3)DesignCollaboration (2/3) Design review discussing design revision and revised modeling Design revision is followed to eliminateDesign revision is followed to eliminate detected errors in CATIA V5 BIM Design review and collaboration amongDesign review and collaboration among architect, structural engineer and MEP engineer Design & 3D Modeling Design Co-ordinate ti Revised 3D d li Simplified workflow of design collaboration Modeling error checking meeting modeling
  • 49.
    Design Collaboration (3/3)DesignCollaboration (3/3) D t t d t l hi d t d i t IDetected system clashing documented into Issue Report by XML or PDF format for releasing purposepurpose Summary of detected clashes Detail report of detected clashes BRE398: Building Information Modeling
  • 50.
    Issue ReportIssue Report Reportof design errors was logged and meetings h ld li / d i l /were held among clients / design consultants / support team for design revision
  • 51.
    Co-ordination Meeting ProceduresCoordination Meeting Procedures MEETING TYPE PROJECT STAGE FREQUENCY PARTICIPANTS LOCATION BIM Requirements Kick-off Planning Once Client BIM Management Staff C lt t T TBD Kick off Consultant Team BIM Plan Review ALL Monthly Client BIM Management Staff Consultant Team TBD D i D t 3D Design Coordination Design Documents Construction Documents Bi-weekly BIM Project Manager Consultant Team TBD M h i l S Design Documents Client BIM P j t MMechanical Space Review Design Documents Construction Documents TBD BIM Project Manager Consultant Team Construction Team TBD Model C i i i Construction D t 75% TBD BIM M t St ff TBDCommissioning Checks Documents, 75% Submittal Approval TBD BIM Management Staff TBD 3D Construction Coordination Construction Weekly BIM Project Manager Construction Team TBD BRE398: Building Information Modeling
  • 52.
    BIM Model PresentationBIMModel Presentation Th h ti ftThrough native software By CAD native Viewer B 3rd P t ViBy 3rd Party Viewers 3D Adobe http://get.adobe.com/reader/http://get.adobe.com/reader/ VRML http://www.cortona3d.com/corto na3d viewersna3d-viewers 3DXML http//www.3ds.com/products- / / / /services/3dvia/3d-xml/1/ ….. BRE398: Building Information Modeling
  • 53.
    Selection of 3DViewerSelection of 3D Viewer Data compatibility Functions Model Size Contents 3D View Navigation Supporting Platform PCNavigation Sectioning Animation PC Web M bil d iAnimation Measurement Mobile devices Security View capture Rendering BRE398: Building Information Modeling
  • 54.
    2D dwg, 3Dmodel to CSD and CBW process 2D drawing (Arch, Struct and E&M) Simplified 2D drawing Build 3D model (Arch, Struct & E&M) Clash detection Clash and Issue Report Co-ordinated with Main Contractor/ Sub-contractor CBW dwg. Services adjustmentadjustment CSD dwg. Confirmed by Sub-contractor
  • 55.
    As-Design BIM Implementation Process Pj er Project Mission Owne RequirementsRequirements BIM standard Nomination BIMTeam standard & Guidelines Nomination Guidelines BIM Approval Provide Provide Approv al DesignB BIM Execution Plan BIM Deliverables Provide Issue Reports Provide program and space validation reportBIM Quality As- Management Plan
  • 56.
    As-Construction BIM Implementation ProcessOwner Approve BEP Approval Osign am BIM BIMCOBi As-Des BIMTea Execution PLan BIM Deliverable COBie Data ruction eam BIM Execution PLan BIM Deliverable COBie Data Provide scheduling & phasing models Operations Planning Set Provide cost estimate As-Const BIMTe models Coordination with Design Team & Owner Provide issue reports Beneficial Occupancy Set Provide issue reports A Owner
  • 57.
    As-Build BIM Implementation Process Ensureno er Identify major equipment Identify required fields Ensure no errors or omissions Owne Coordinate fields, Equipments, documentation Validate data Popula te data in fields Design Team Owner as fields Update Add field As-D BIMtion am Validate field data Validate field data Owner as- build data deliverable data from approved submittals data when installe d As- Construct BIMTea Add performanc e data from C Validated field data Validate fields, equipments Validate data missioning TeamC Cxequipments Comm T
  • 58.
    Communication ProceduresCommunication Procedures Eli C i i dElectronic Communication procedures Communication protocol should be established between all project team members to ensure smooth collaborationproject team members to ensure smooth collaboration. Electronic communication between stakeholders can be created, uploaded, sent out and archived through the, p , g project management system. Copies of all the project related communication should be d f f k d f fsaved for safekeeping and future reference. Document management (file folder structure, permissions and access folder maintenance folder notifications file namingaccess, folder maintenance, folder notifications, file naming convention, etc.) should also be resolved and set up at the earliest possible time. BRE398: Building Information Modeling
  • 59.
    File Transfer ProtocolFileTransfer Protocol A l k f F l T f P l (FTP)An electronic workspace of File Transfer Protocol (FTP) or Asset Lifecycle Management system (ALM) will be established for the purpose of efficient and timely transferestablished for the purpose of efficient and timely transfer of model and database files. This workspace will provide a collaborative location where the current contract BIM files, coordination files, and fully coordinated submittal files will reside. h M d b d bEach BIM coordination team member stores and obtains data from this location. Project team members are to upload updated copies of their files, provide notification, and toupdated copies of their files, provide notification, and to make collaboration comments and annotations as often as necessary to maintain project schedule. BRE398: Building Information Modeling
  • 60.
    Communication ProceduresCommunication Procedures Mi C i i P dMeeting Communication Procedures A schedule for initial delivery of each model to the BIM P j M d h d l f d i hProject Manager, and a schedule for updating each model after the coordination session. Procedure and protocol for the submission andProcedure and protocol for the submission and approval of the model including electronic stamping. IT-related issues: file format to be used file-namingIT related issues: file format to be used, file naming and object-naming conventions, file structure, software used, and interoperability of applications. Coordination and scheduling of conflict detection and resolution procedure. BRE398: Building Information Modeling
  • 61.
    Network File StructureNetworkFile Structure BRE398: Building Information Modeling
  • 62.
    Ftp Server Submission& Approval Process Architect Architect Work Model 5. Review model with Architect 3. Checks email 2. Email for notification of Structural 3D Coordinator 8. Update status – Updated in current model notification of upload the BIM model Structural Work Model 1 C fil t f ld 7. Update files to Current Model Mail Inbox MEP Work Model ftpbimtransferinbox 1. Copy files to folder ft bi k 3d BRE398: Building Information Modeling Model ftpbimtransferinbox ftpbimworkspace3d
  • 63.
    Information ExchangesInformation Exchanges Theproject team should document the information exchanges created as part of the planning process when creating the BIM Plan. The level of development (LOD) for each modelp ( ) element is based on the model content criteria. The LOD will assist in determining the level ofLOD will assist in determining the level of involvement for each project stakeholder from project conception through project turnover.project conception through project turnover. BRE398: Building Information Modeling
  • 64.
    Data Exchange forDifferent PurposesData Exchange for Different Purposes BRE398: Building Information Modeling
  • 65.
    Data Propagation inthe ProjectData Propagation in the Project BRE398: Building Information Modeling
  • 66.
    Data Exchange inBetween Applications BRE398: Building Information Modeling
  • 67.
    Data Exchange inBetween SoftwaresData Exchange in Between Softwares BRE398: Building Information Modeling
  • 68.
    Standard Data ExchangeFormat for CAD IGES STEP XMLIGES DXF XML STL DWG DXF STL VRMLIFC + CAD Native Format Direct Interface BRE398: Building Information Modeling
  • 69.
    BIM Data Exchange- IFCBIM Data Exchange IFC IFC stands for Industry Foundation Class IFC is an international standard - ISO16739 IFC is authored / maintained by buildingSMART, formerly known as the International Alliance forformerly known as the International Alliance for Interoperability (AIA) b ildi SMART UK i b th B ildi R hbuildingSMART UK is run by the Building Research Establishment (BRE) BRE398: Building Information Modeling
  • 70.
    COBie DefinitionCOBie Definition ConstructionOperations Building Information Exchange (COBie) is a data format for the publication of a subset of building model information focused on delivering building information not geometric modeling. It is closely associated with building information modeling (BIM) approaches to design, construction and management of built assets.g BRE398: Building Information Modeling
  • 71.
    IFC vs COBieIFCvs COBie A BIM with just the A full BIM contains all f th t tiinformation from the CAD model of the construction information about the building BRE398: Building Information Modeling building
  • 72.
    COBie (Construction Operations BuildingInformation Exchange) Ideal World BRE398: Building Information Modeling
  • 73.
    COBie exchange toIFCCOBie exchange to IFC M MThe xBIM Toolkit can allow a user to create a BIM model in IFC format. xBIM performs validation on th BIM d l d th t th l tthe BIM model, and then exports the relevant information into COBie format. Si COBi i i d h (h d bl )Since COBie is in a spreadsheet (human-readable) format, a user can easily update the COBie file. A d d COB h d b k hAn updated COBie is then imported back with changes propagating to the IFC BIM model, and b tl th IFC fil l b i t d i tsubsequently the IFC file can also be imported into any proprietary software such as Autodesk Revit. BRE398: Building Information Modeling
  • 74.
    Real worldReal worldRealworldReal world We cannot avoid data lostWe cannot avoid data lost for CAD data exchange infor CAD data exchange in between different software !between different software !between different software !between different software ! Even within the same software….. BRE398: Building Information Modeling
  • 75.
    Model Delivery/ Exchangeschedule for Submission and Approval INFORMATION EXCHANGE FILE SENDER FILE RECEIVER FREQUENCY START DATE MODEL FILE MODEL SOFTWARE Native File Type File EXCHANGE TYPE Design A thoring BIM PM Consultant Team Monthly TBD Revit Catia Revit Catia RVT CATIA Prod ct Nwd 3dxml pdfAuthoring – 3D Design Coordination Product pdf Design – Construction BIM PM Consultant Team Bi-weekly TBD Revit Catia Revit Catia RVT CATIA Nwd 3dxml Construction Team Catia Catia Product pdf Construction Document for Bidding Client Consultant BIM PM TBD TBD Revit Catia Revit Catia RVT CATIA Product Nwd 3dxml pdf BIM PM Consultant T W kl TBD Revit Revit RVT CATIA Nwd 3d l 3D Construction Coordination BIM PM Team Sub-contractor Weekly TBD Revit Catia Revit Catia CATIA Product 3dxml pdf 3D Si l ti3D Simulation for Construction Sequences BIM PM Main Contractor Sub-contractor TBD TBD Cortona Delmia Cortona Delmia VMP HTM WRL Construction BRE398: Building Information Modeling
  • 76.
    TopicsTopics BIM Project ExecutionPlan Project Organization Structurej g BIM Data Model Structure P j t I l t ti P & C i tiProject Implementation Process & Communication Quality & Risk Management BRE398: Building Information Modeling
  • 77.
    Quality ChallengesQuality Challenges BRE398:Building Information Modeling
  • 78.
    Quality ManagementQuality Management Id t d l lit i j t h t lIn order to assure model quality in every project phase, control procedures need to be set in place. Each of the models created during project progression and d l d b l d d d ldevelopment needs to be pre-planned considering model content, level of detail, format and responsible party for updates, quality and distribution of the model to all the parties involved in the di ti ff tcoordination efforts. Each of the parties contributing to the BIM model should have a responsible person or Model Manager to handle the model. Model Managers, as part of the core BIM team, are in charge of participating in design reviews and coordination sessions along with taking care of all the issues that might arise with keeping the model updated, accurate and comprehensive. BRE398: Building Information Modeling
  • 79.
    Quality Control ChecksQualityControl Checks CHECKS DEFINITION Vi l h k Ensure there are no unintended model components and the Visual check Ensure there are no unintended model components and the design intent has been followed Interference check Detect problems in the model where two building components are clashing including soft and hardcheck components are clashing including soft and hard Section check Cut section to compare with the 2D drawing and take measurement for critical areas Standard check Ensure that the BIM and AEC Standard have been followed (fonts, dimensions, line styles, levels/layers, color, etc) Model integrity check Describe the QC validation process used to ensure that the Project Facility Data set has no undefined, incorrectly defined or duplicated elements and the reporting process on non- compliant elements and corrective action plans Random check Checking any missing, un-reasonable and clash matter thro’ the model BRE398: Building Information Modeling t e ode
  • 80.
    Quality Checking WorkFlowQuality Checking Work Flow Drawing received Modeling Deliverable c/w model  reference list Alignment  checking Drawing checking by  Alva/Max/Jerome Model checking  by  Alva/Max/Jerome  Visual  checking Check Clash  analysis  checkingDrawing  vesion  i Error Model inter‐cross checking   by Alva/Max/Jerome Reference drawing  checking Visual  checking comparsion Sectioning  checking Check Sectioning  checking Error Model checking  by Alva Check checking Reference  drawing  checking Error Model checking  by Brian Visual  checking Error Check
  • 81.
    Risk ManagementRisk Management ThBIM d l t l t th d liThe BIM modelers cannot complete the modeling on time Client’s project manager doesn’t buy inClient s project manager doesn t buy in Design changes frequently Members change from the project teamsMembers change from the project teams No commitment from the consultants Design drawings are delayedDesign drawings are delayed H5N1 Software bugs and blockedSoftware bugs and blocked Project stopped by Owner BRE398: Building Information Modeling
  • 82.
    Contingency PlanContingency Plan ThBIM d l t N it t f thThe BIM modelers cannot complete the modeling on time T t d t No commitment from the project manager and consultants M ti ti d f i dlTop management needs to give a hand Notice in advance Motivation and friendly communication Highlight the values of BIM Members change from the project team Back up resources H5N1 Schedule extension Home office Ask additional resources for re-training Design drawings are delayed Software bugs and blocked Work around methods P j d b O g g y or design change frequently Ask for extension Project stopped by Owners Ensure committed deliverables BRE398: Building Information Modeling
  • 83.
    Questions & Answers stephenau@mtech.com.hk BRE398:Building Information ModelingBRE398: Building Information Modeling
