Building Information Modeling & Value
to the AEC Industry
Part 1Part 1
Stephen AUp
Sept 26, 2013
Lecture Class BRE398: Building Information Modeling
BRE398: Building Information Modeling
TopicsTopics
Building Construction Challenges
Building Information Modelingg g
3D BIM
Architectural / Structural / MEP DesignArchitectural / Structural / MEP Design
Realistic Simulation
4D BIM4D BIM
5D BIM
V l f BIM t th i d tValue of BIM to the industry
BRE398: Building Information Modeling

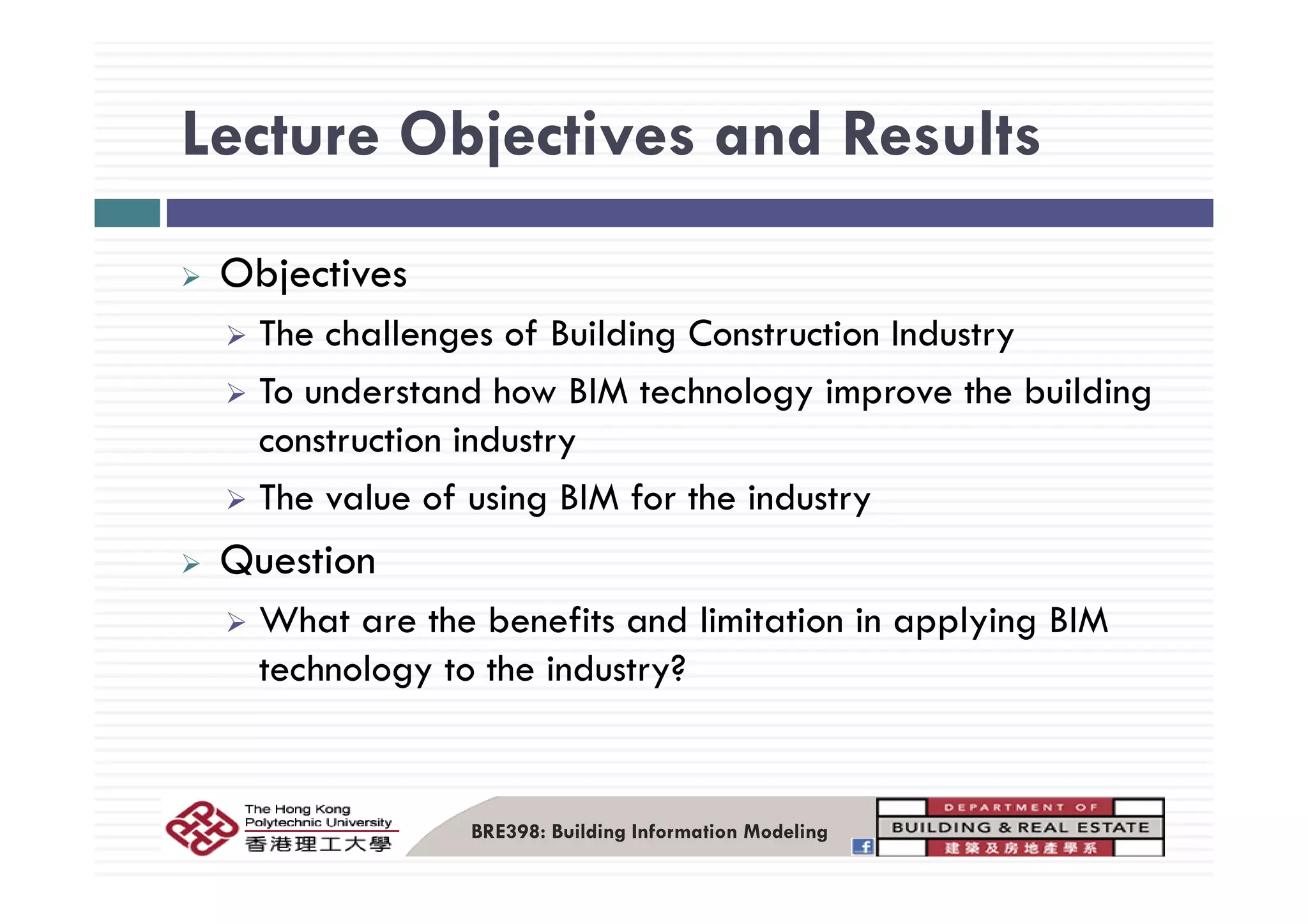

Lecture Objectives and ResultsLecture Objectives and Results
Objectives
The challenges of Building Construction Industry
To understand how BIM technology improve the building
construction industry
The value of using BIM for the industry
QuestionQuestion
What are the benefits and limitation in applying BIM
technology to the industry?technology to the industry?
BRE398: Building Information Modeling
TopicsTopics
Building Construction Challenges
Building Information Modelingg g
3D BIM
Architectural / Structural / MEP DesignArchitectural / Structural / MEP Design
Realistic Simulation
4D BIM4D BIM
5D BIM
V l f BIM t th i d tValue of BIM to the industry
BRE398: Building Information Modeling
5

What doe the building look like?
H h d it t?How much does it cost?
When will it be finish?
BRE398: Building Information Modeling
Construction Mega-Trendsg

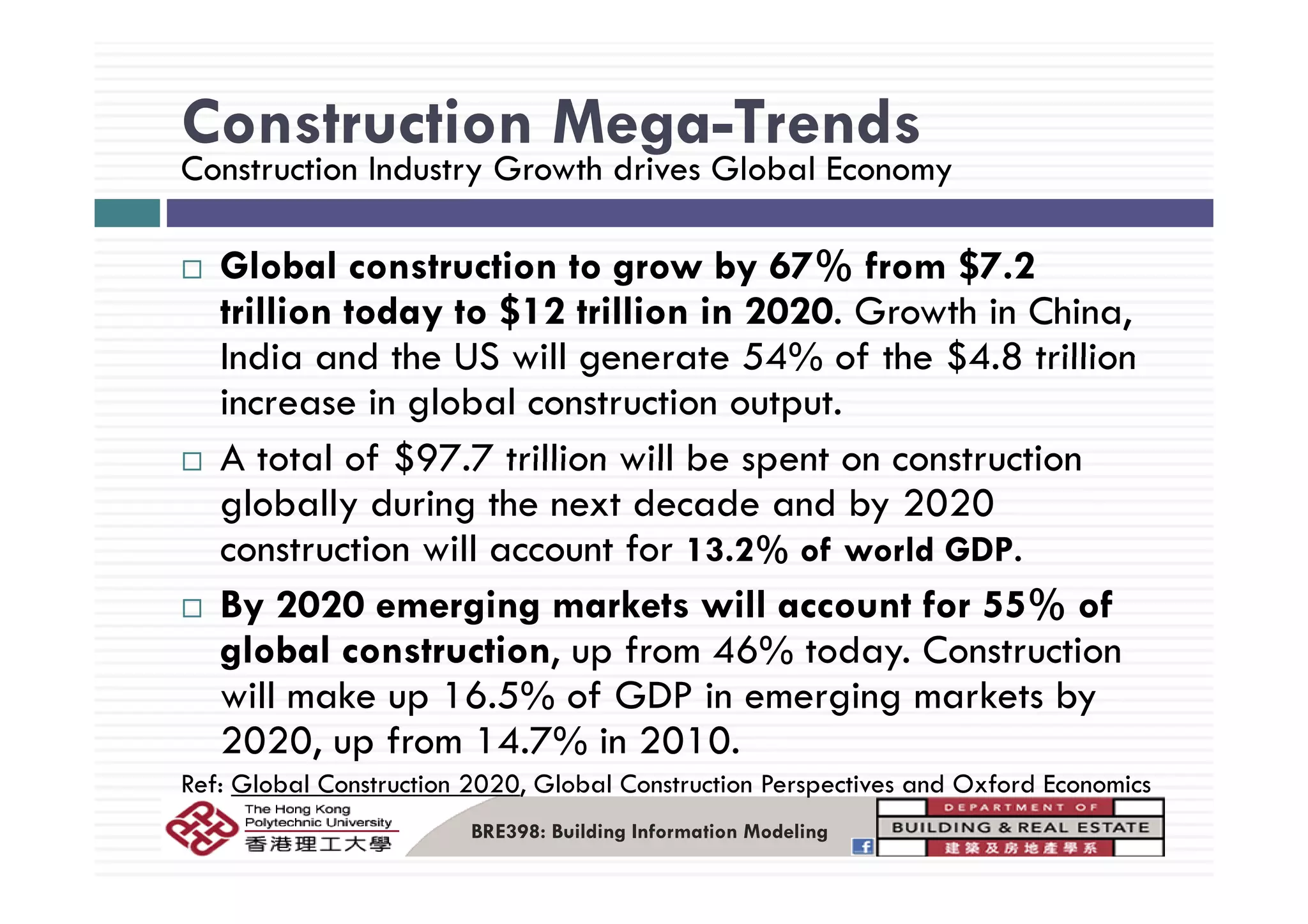

Gl b l i b % f $ 2
Construction Industry Growth drives Global Economy
Global construction to grow by 67% from $7.2
trillion today to $12 trillion in 2020. Growth in China,
India and the US will generate 54% of the $4 8 trillionIndia and the US will generate 54% of the $4.8 trillion
increase in global construction output.
A total of $97 7 trillion will be spent on constructionA total of $97.7 trillion will be spent on construction
globally during the next decade and by 2020
construction will account for 13.2% of world GDP.
By 2020 emerging markets will account for 55% of
global construction, up from 46% today. Construction
will make up 16.5% of GDP in emerging markets by
2020, up from 14.7% in 2010.
R f Gl b l C i 2020 Gl b l C i P i d O f d E i
BRE398: Building Information Modeling
Ref: Global Construction 2020, Global Construction Perspectives and Oxford Economics

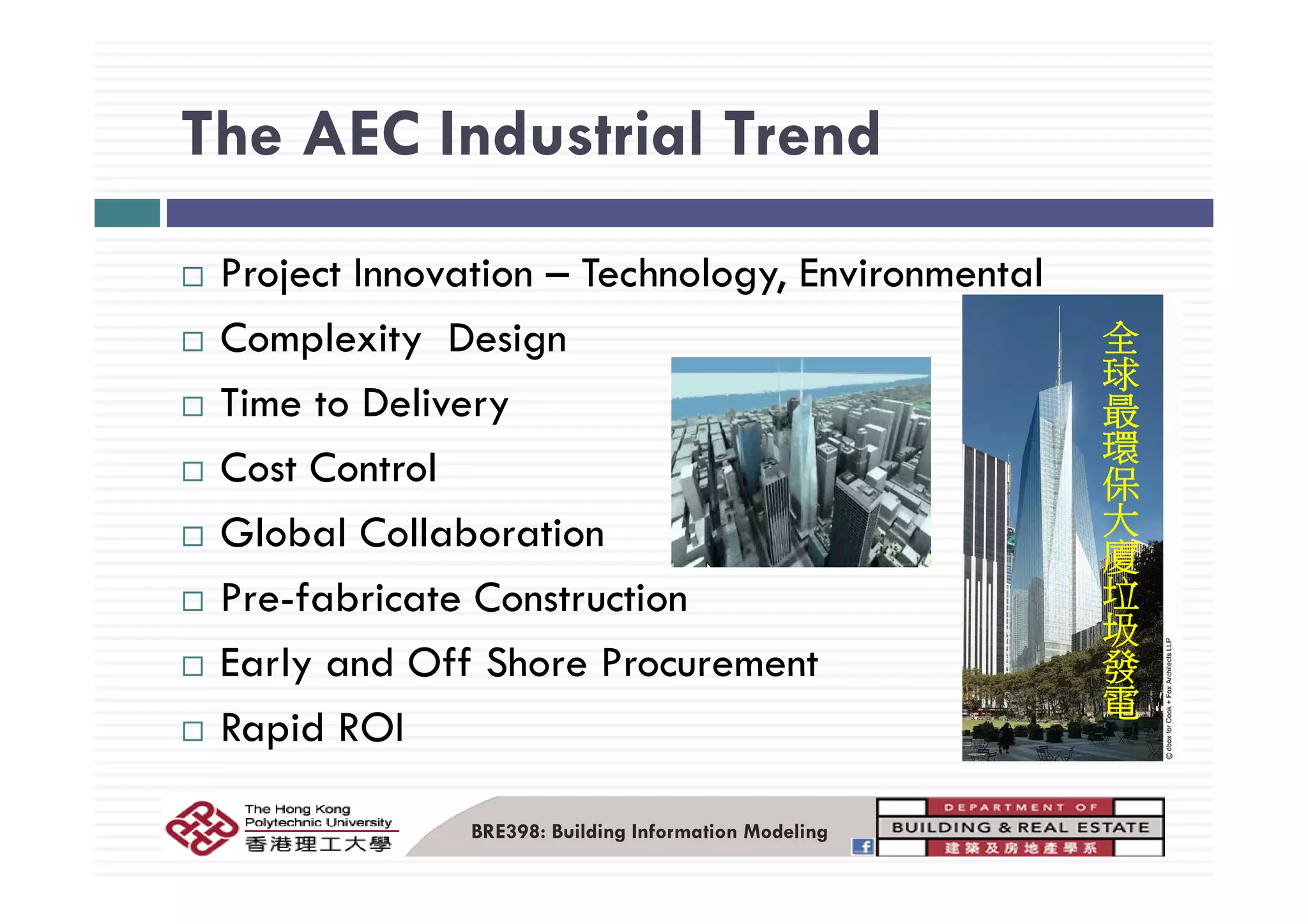

The AEC Industrial TrendThe AEC Industrial Trend
Project Innovation – Technology, Environmental
Complexity Design
全
球p y g
Time to Delivery
C t C t l
球
最
環
Cost Control
Global Collaboration
環
保
大廈
Pre-fabricate Construction
Early and Off Shore Procurement
廈
垃
圾發
Early and Off Shore Procurement
Rapid ROI
發
電
BRE398: Building Information Modeling
Challenges along a Building Project

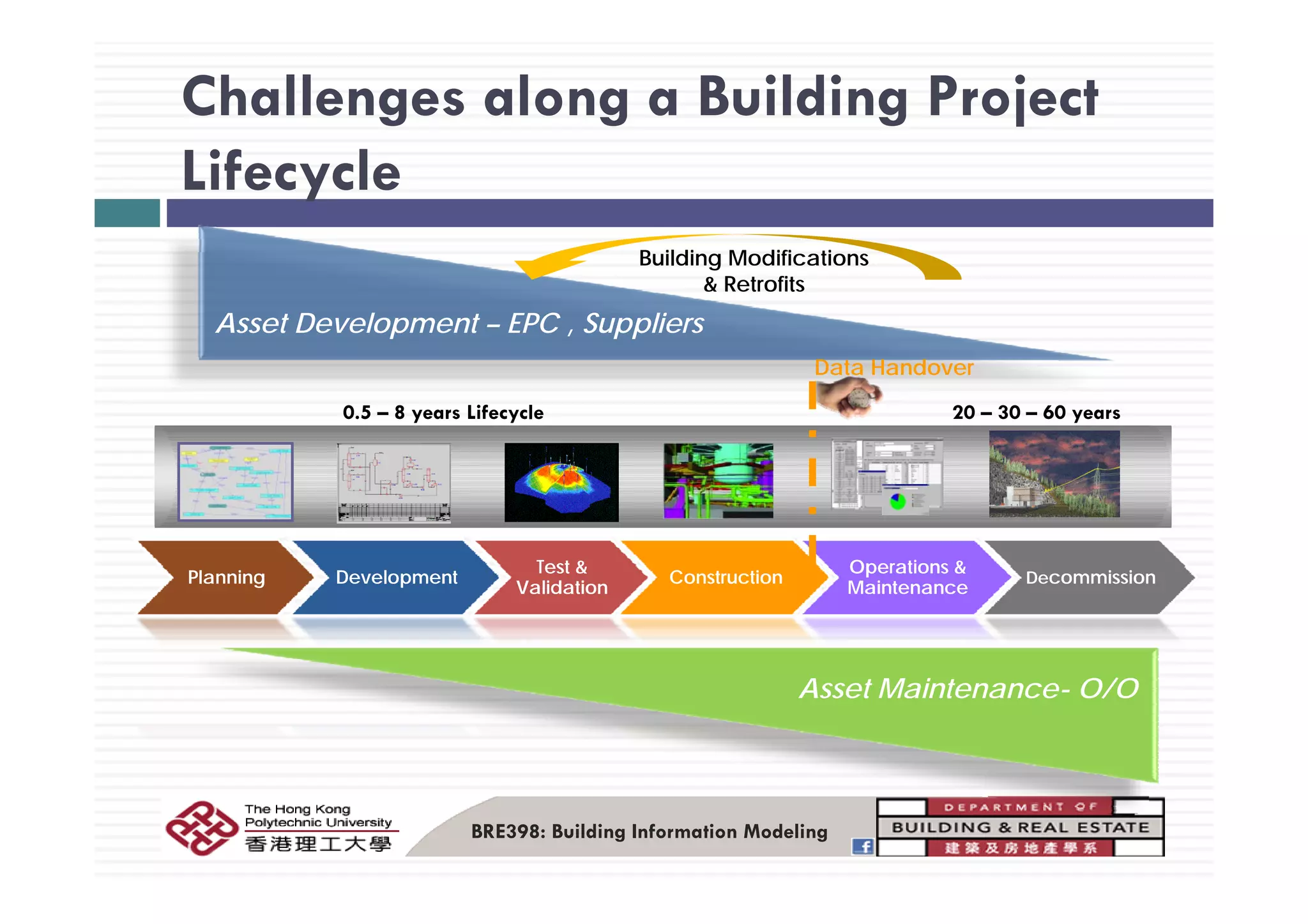

B ildi M difi ti
Lifecycle
Asset Development – EPC , Suppliers
Building Modifications
& Retrofits
Data Handover
0.5 – 8 years Lifecycle 20 – 30 – 60 years
Test &Test & Operations &Operations &
PlanningPlanning DevelopmentDevelopment
Test &Test &
ValidationValidation
ConstructionConstruction
Operations &Operations &
MaintenanceMaintenance
DeDecommissioncommission
Asset Maintenance- O/O
BRE398: Building Information Modeling
Building Project Management
9

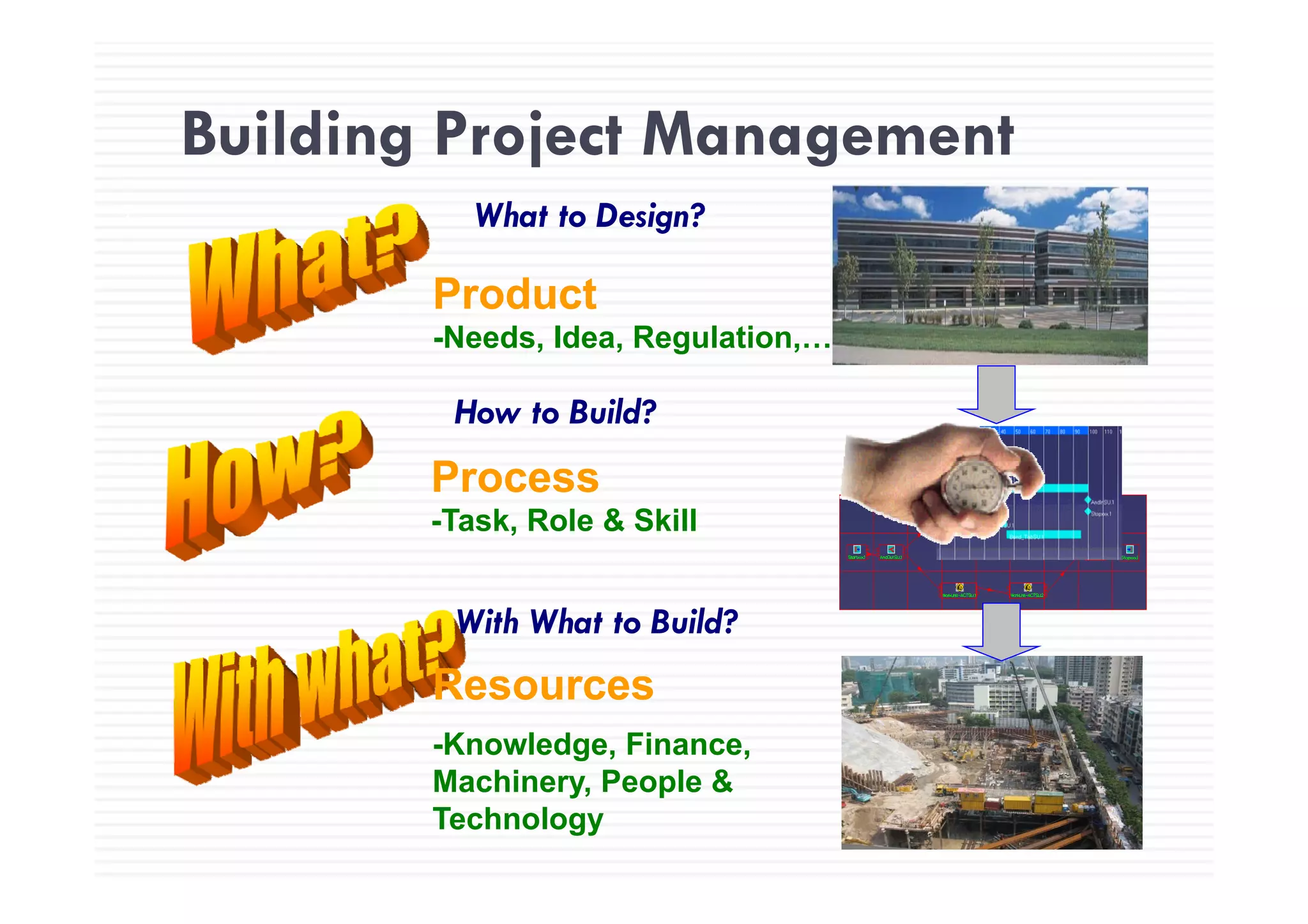

Building Project Management
What to Design?
PProductroduct
-Needs, Idea, Regulation,…
How to Build?
PPProcessProcess
-Task, Role & Skill
With What to Build?
RRResourcesResources
-Knowledge, Finance,
Machinery People &Machinery, People &
Technology

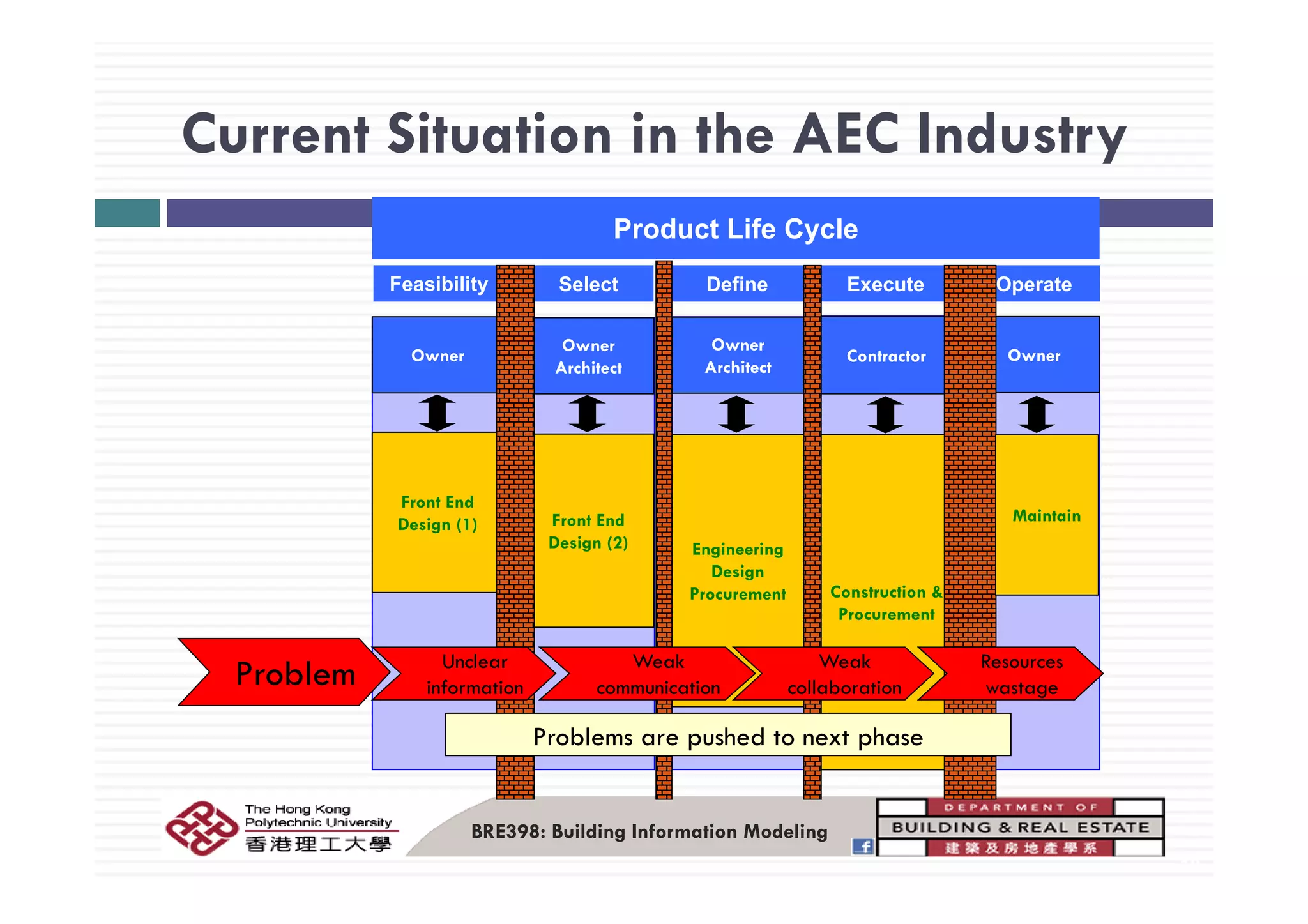

Current Situation in the AEC IndustryCurrent Situation in the AEC Industry
Product Life Cycle
Feasibility Select Define Execute Operate
Owner
Owner Owner
Contractor OwnerOwner
Architect Architect
Contractor Owner
Front End
Design (1) Front End
Design (2) Engineering
D i
Maintain
Design
Procurement Construction &
Procurement
Unclear Weak Weak Resources
Problem information
Problems are pushed to next phase
communication collaboration wastageProblem
BRE398: Building Information Modeling
10

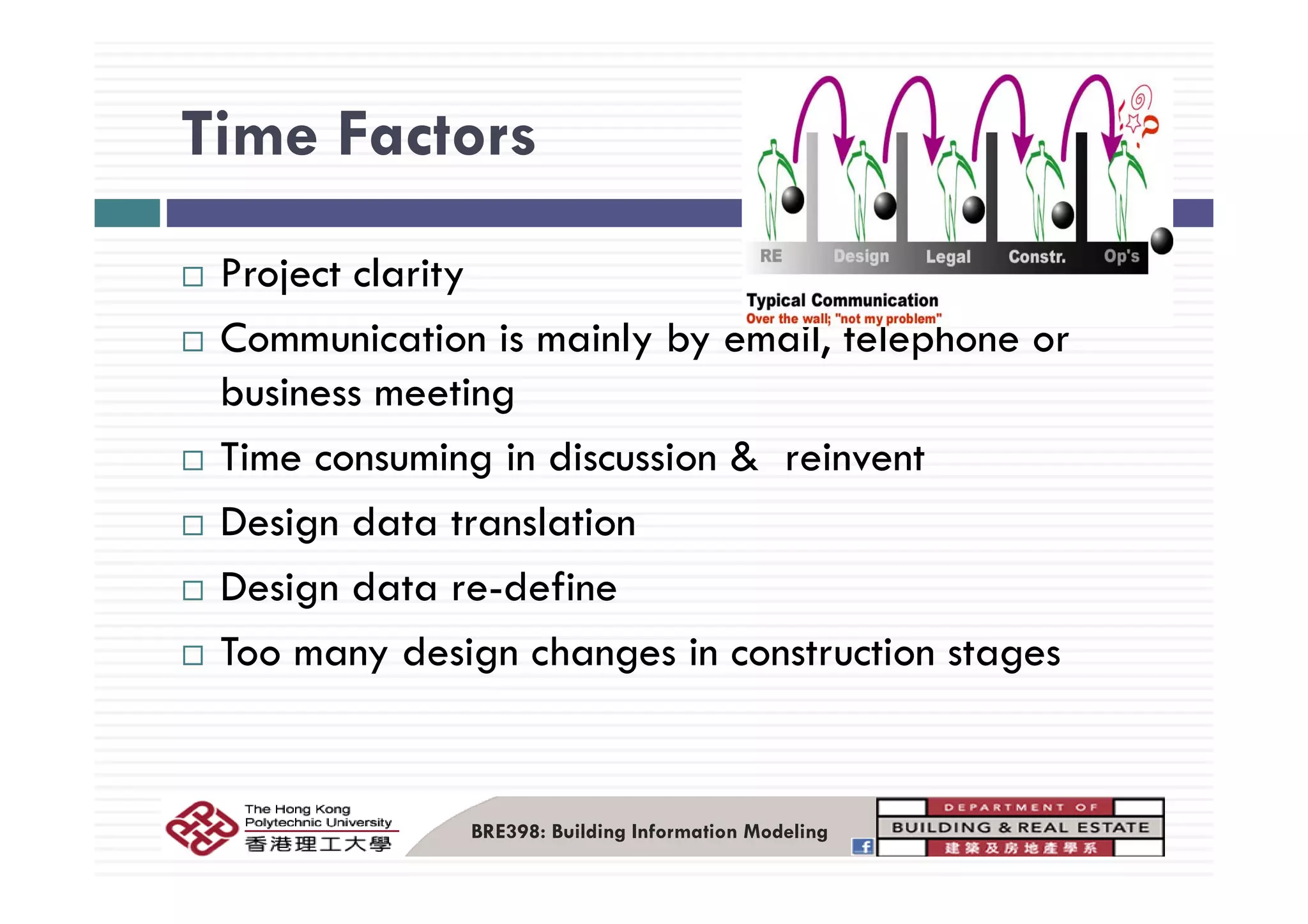

Time FactorsTime Factors
Project clarity
Communication is mainly by email, telephone ory y , p
business meeting
Time consuming in discussion & reinventTime consuming in discussion & reinvent
Design data translation
Design data re-define
Too many design changes in construction stagesy g g g
BRE398: Building Information Modeling

Quality Factors – Multi-disciplines
Conflict

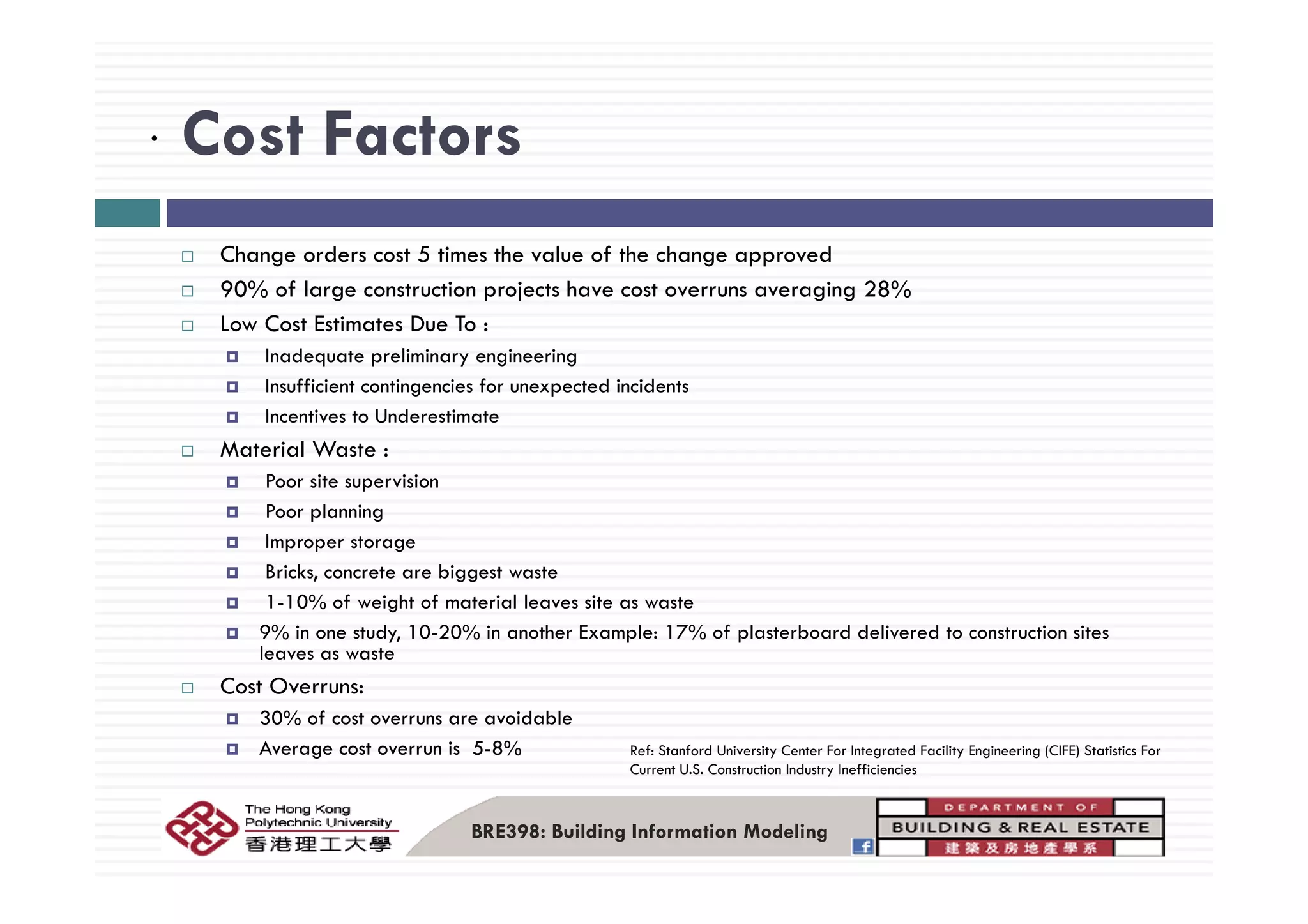

• Cost FactorsCost Factors
Change orders cost 5 times the value of the change approvedChange orders cost 5 times the value of the change approved
90% of large construction projects have cost overruns averaging 28%
Low Cost Estimates Due To :
Inadequate preliminary engineeringInadequate preliminary engineering
Insufficient contingencies for unexpected incidents
Incentives to Underestimate
Material Waste :
Poor site supervision
Poor planning
Improper storage
B i k t bi t tBricks, concrete are biggest waste
1-10% of weight of material leaves site as waste
9% in one study, 10-20% in another Example: 17% of plasterboard delivered to construction sites
leaves as waste
Cost Overruns:
30% of cost overruns are avoidable
Average cost overrun is 5-8% Ref: Stanford University Center For Integrated Facility Engineering (CIFE) Statistics For
Current U.S. Construction Industry Inefficiencies
BRE398: Building Information Modeling
y

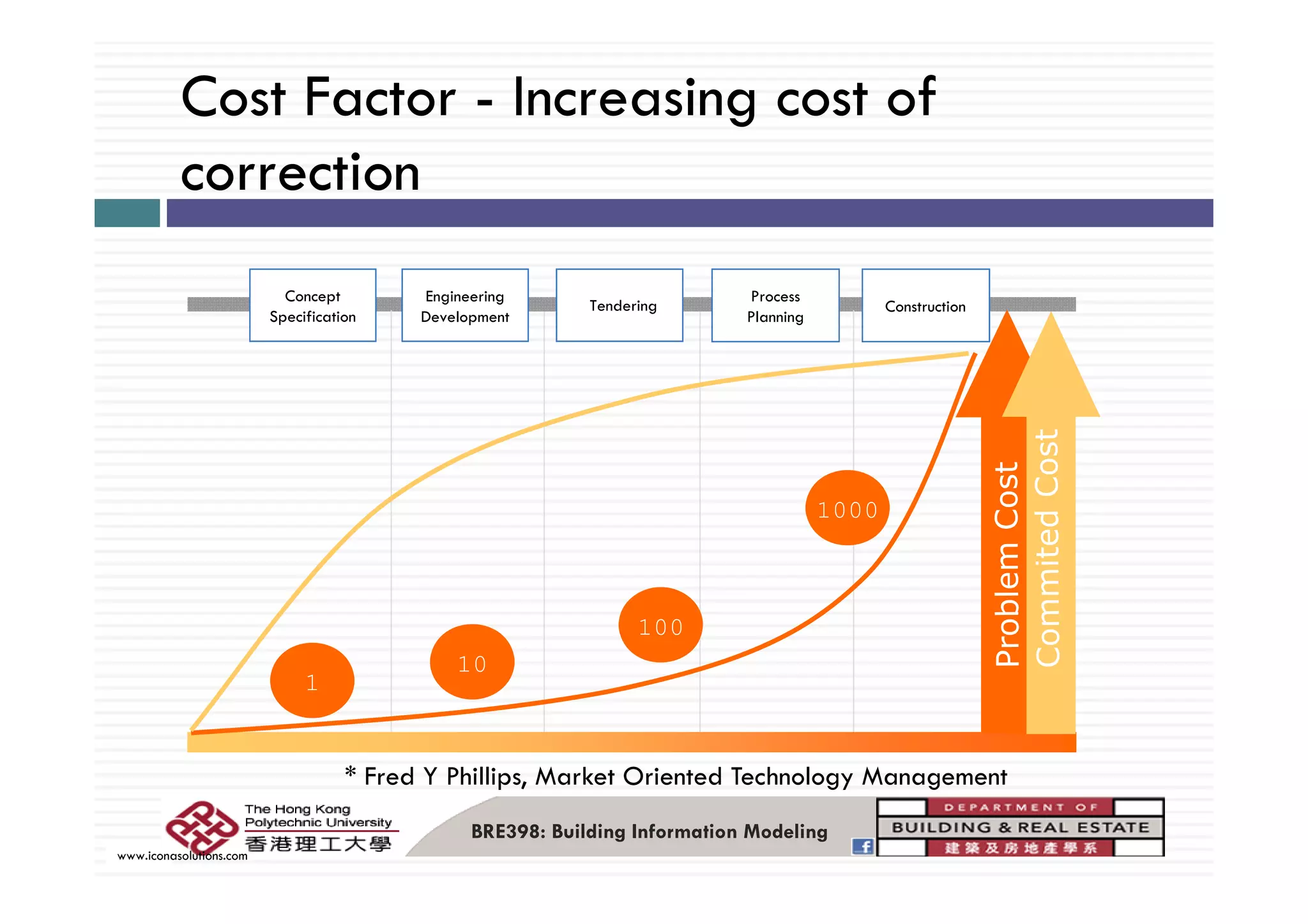

Cost Factor - Increasing cost of
correction
Concept
Specification
Engineering
Development
Tendering
Process
Planning
Construction
1000
10
100
* Fred Y Phillips Market Oriented Technology Management
1
0
BRE398: Building Information Modeling
www.iconasolutions.com
Fred Y Phillips, Market Oriented Technology Management

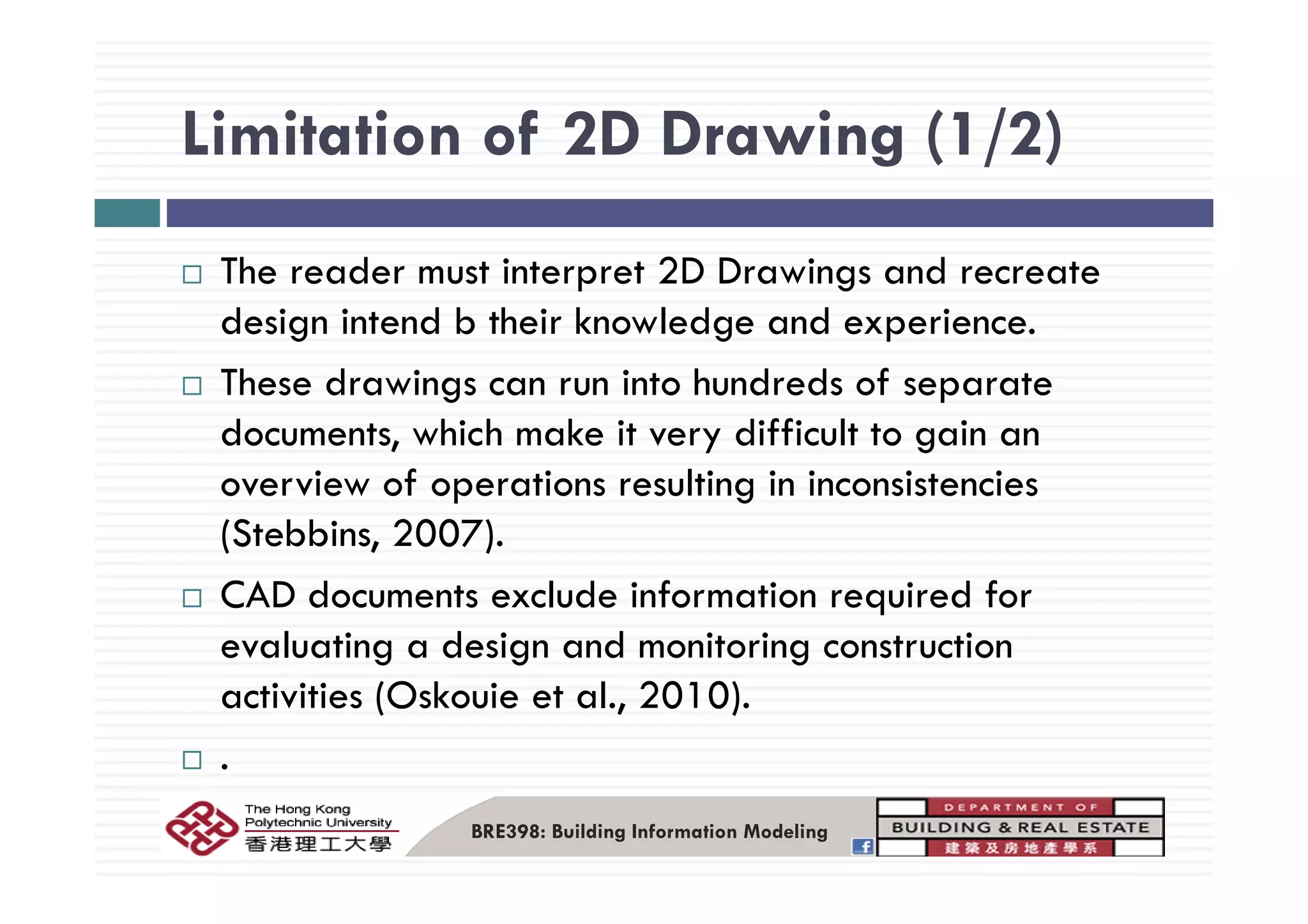

Limitation of 2D Drawing (1/2)Limitation of 2D Drawing (1/2)
The reader must interpret 2D Drawings and recreate
design intend b their knowledge and experience.
These drawings can run into hundreds of separate
documents, which make it very difficult to gain an
overview of operations resulting in inconsistencies
(Stebbins, 2007).
CAD documents exclude information required for
evaluating a design and monitoring construction
activities (Oskouie et al., 2010).
.
BRE398: Building Information Modeling

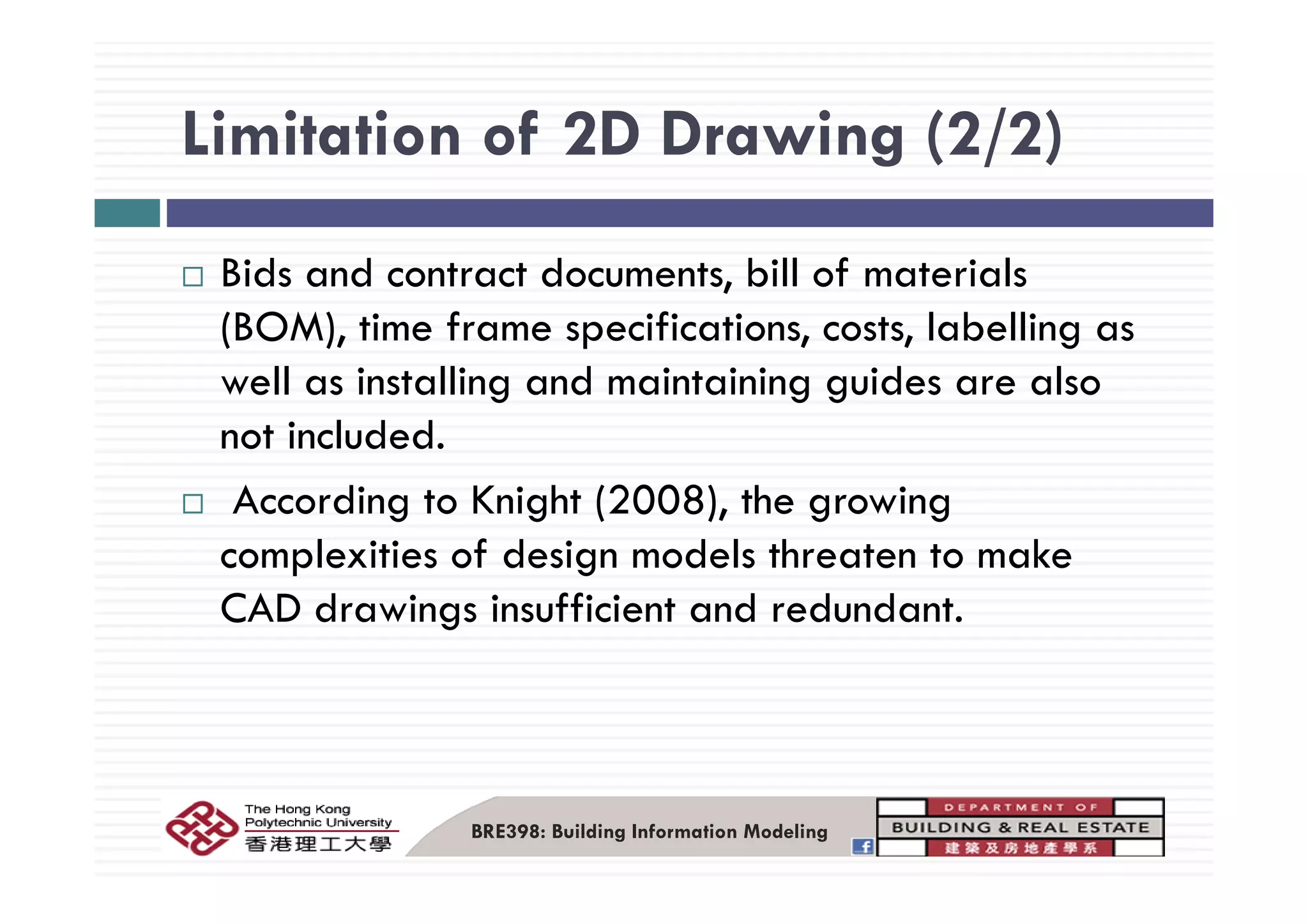

Limitation of 2D Drawing (2/2)Limitation of 2D Drawing (2/2)
Bids and contract documents, bill of materials
(BOM), time frame specifications, costs, labelling as
well as installing and maintaining guides are also
not included.
According to Knight (2008), the growing
complexities of design models threaten to makecomplexities of design models threaten to make
CAD drawings insufficient and redundant.
BRE398: Building Information Modeling

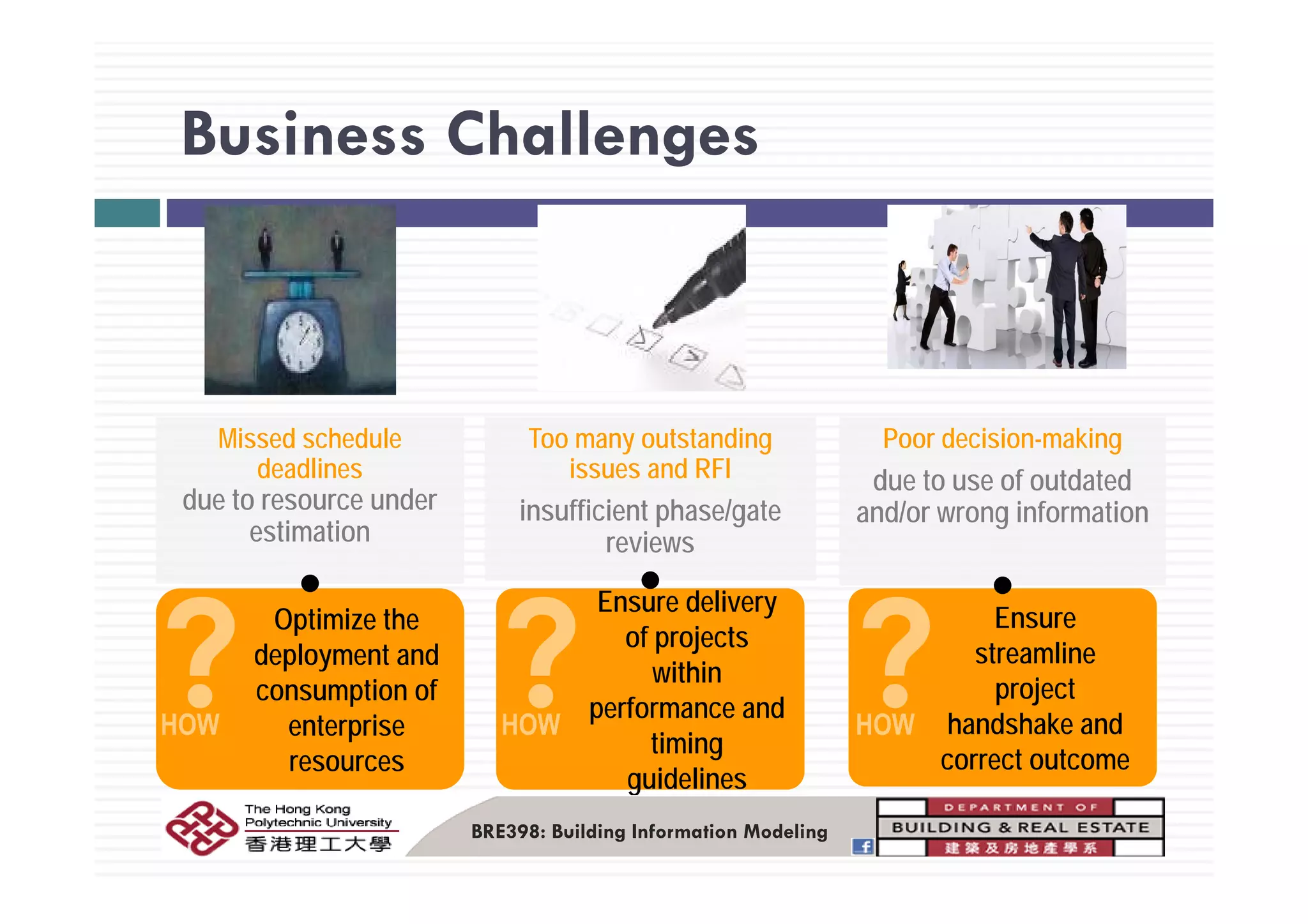

Business ChallengesBusiness Challenges
Missed schedule
d dli
Too many outstanding
i d RFI
Poor decision-making
deadlines
due to resource under
estimation
issues and RFI
insufficient phase/gate
reviews
due to use of outdated
and/or wrong information
Optimize the
deployment and
Ensure delivery
of projects
within
Ensure
streamline
consumption of
enterprise
resources
within
performance and
timing
guidelines
project
handshake and
correct outcome
BRE398: Building Information Modeling
guidelines

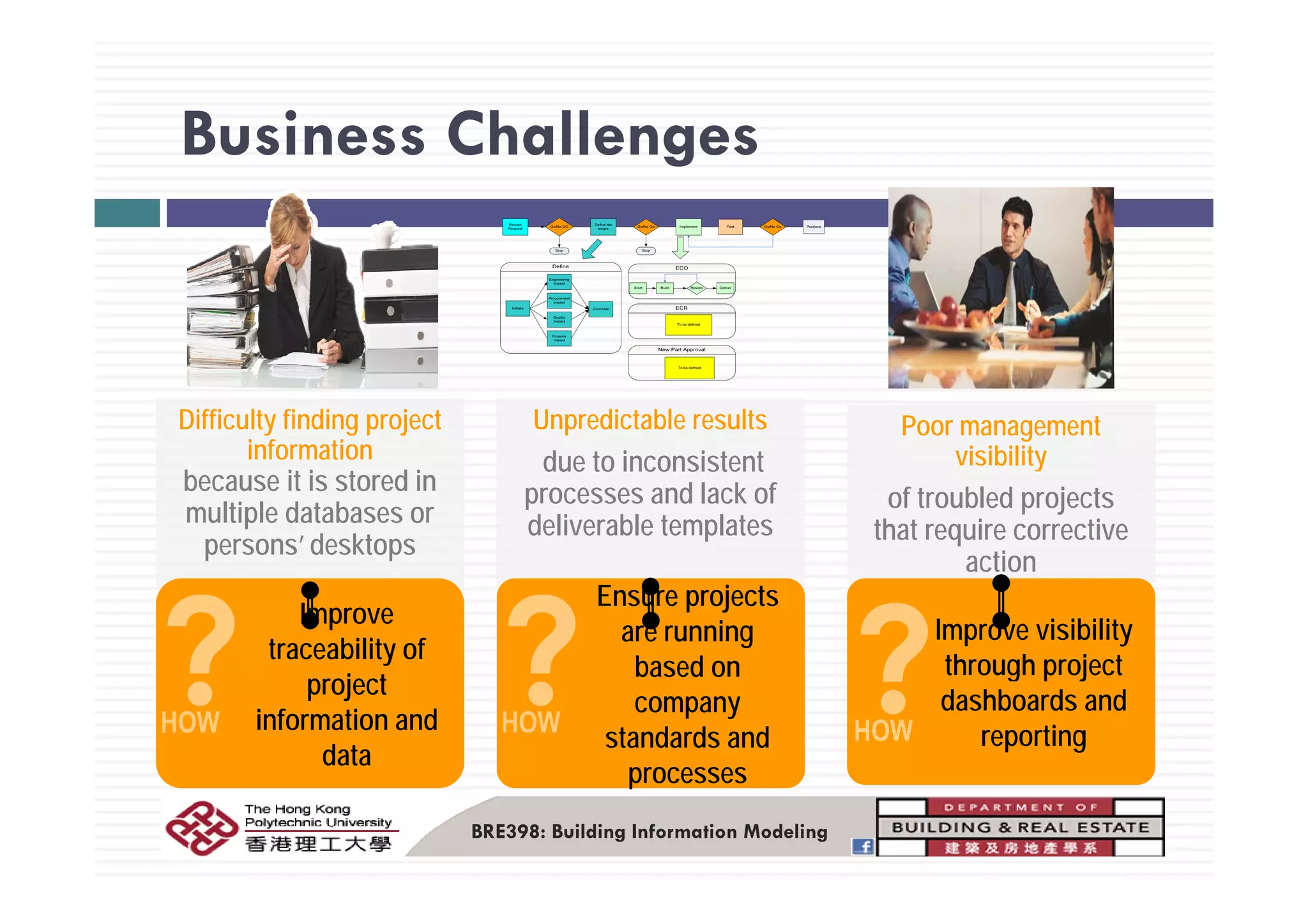

Business ChallengesBusiness Challenges
Difficulty finding project
information
Unpredictable results
due to inconsistent
Poor management
visibility
because it is stored in
multiple databases or
persons’ desktops
due to inconsistent
processes and lack of
deliverable templates
visibility
of troubled projects
that require corrective
actionaction
Improve
traceability of
Ensure projects
are running
based on
Improve visibility
through project
project
information and
data
based on
company
standards and
processes
through project
dashboards and
reporting
BRE398: Building Information Modeling
processes

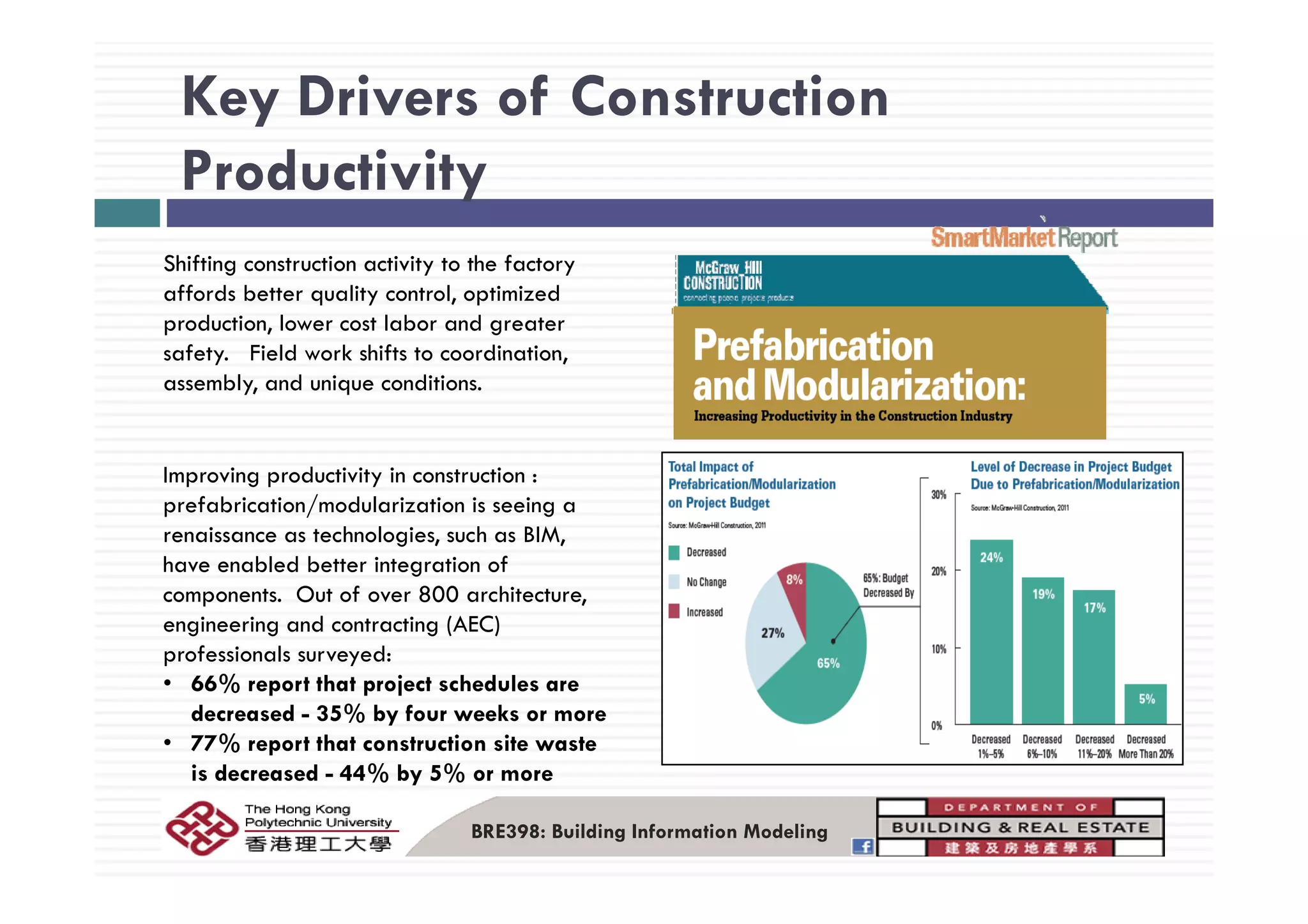

Key Drivers of Construction
Productivity
Shifting construction activity to the factory
affords better quality control, optimized
production, lower cost labor and greater
safety Field work shifts to coordinationsafety. Field work shifts to coordination,
assembly, and unique conditions.
Improving productivity in construction :
prefabrication/modularization is seeing a
renaissance as technologies, such as BIM,
have enabled better integration ofhave enabled better integration of
components. Out of over 800 architecture,
engineering and contracting (AEC)
professionals surveyed:
• 66% report that project schedules are
decreased - 35% by four weeks or more
• 77% report that construction site waste
is decreased - 44% by 5% or more
BRE398: Building Information Modeling
is decreased - 44% by 5% or more

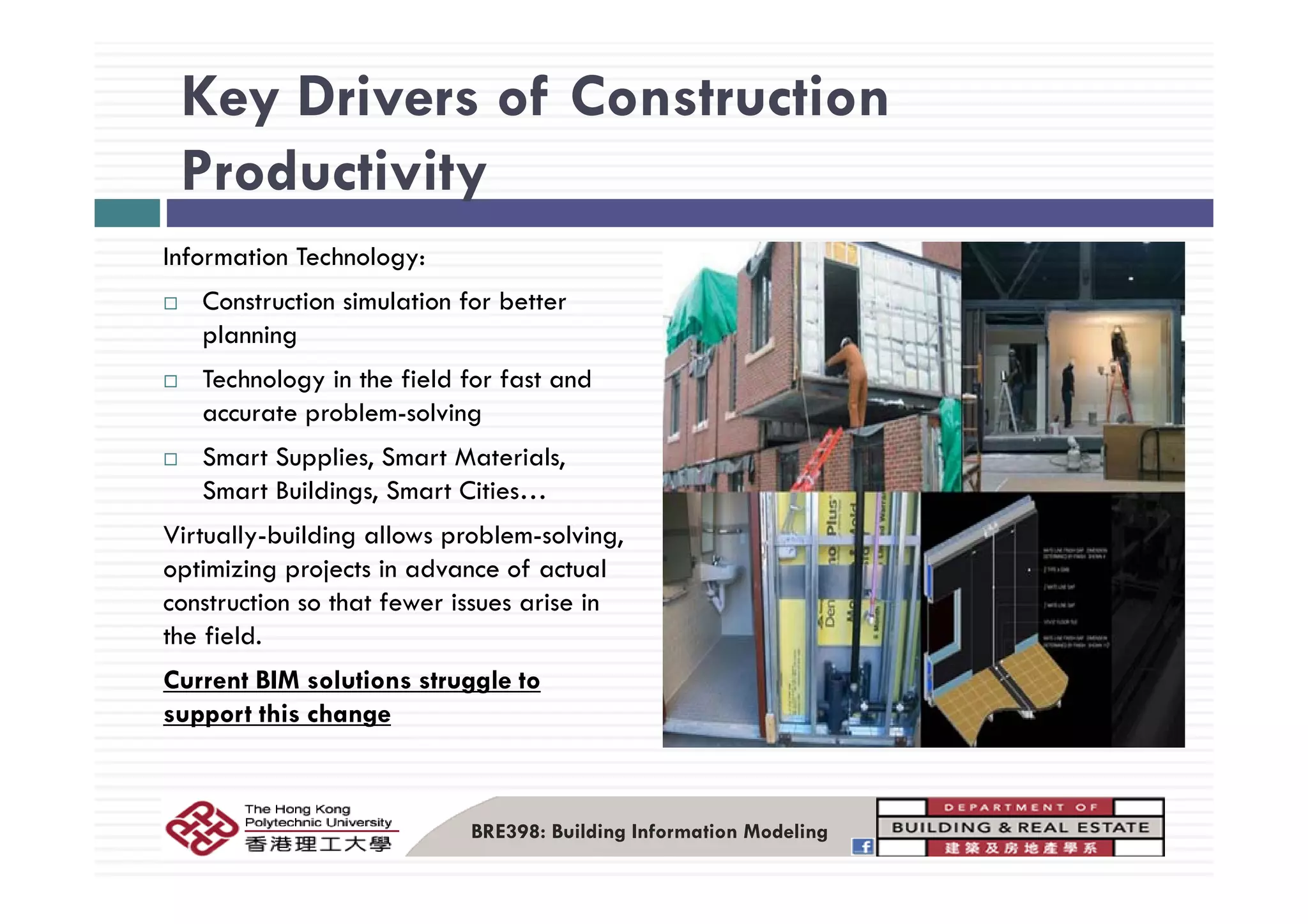

Key Drivers of Construction
Productivity
I f ti T h lInformation Technology:
Construction simulation for better
planning
Technology in the field for fast and
accurate problem-solving
Smart Supplies, Smart Materials,Smart Supplies, Smart Materials,
Smart Buildings, Smart Cities…
Virtually-building allows problem-solving,
optimizing projects in advance of actualoptimizing projects in advance of actual
construction so that fewer issues arise in
the field.
C BIM l i lCurrent BIM solutions struggle to
support this change
BRE398: Building Information Modeling

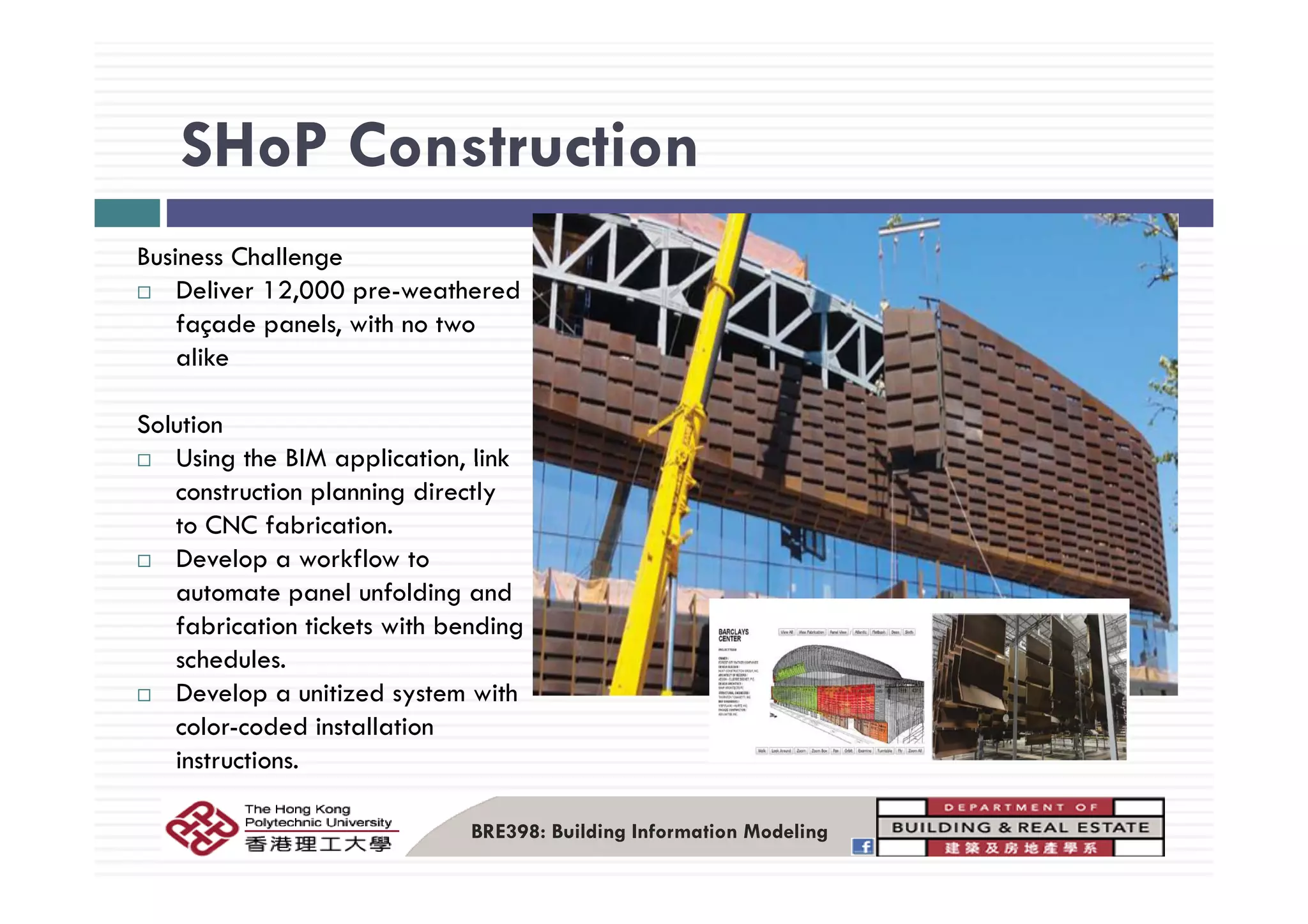

SHoP ConstructionSHoP Construction
B i Ch llBusiness Challenge
Deliver 12,000 pre-weathered
façade panels, with no two
alikealike
Solution
Using the BIM application linkUsing the BIM application, link
construction planning directly
to CNC fabrication.
Develop a workflow toDevelop a workflow to
automate panel unfolding and
fabrication tickets with bending
schedules.
Develop a unitized system with
color-coded installation
instructions.
BRE398: Building Information Modeling

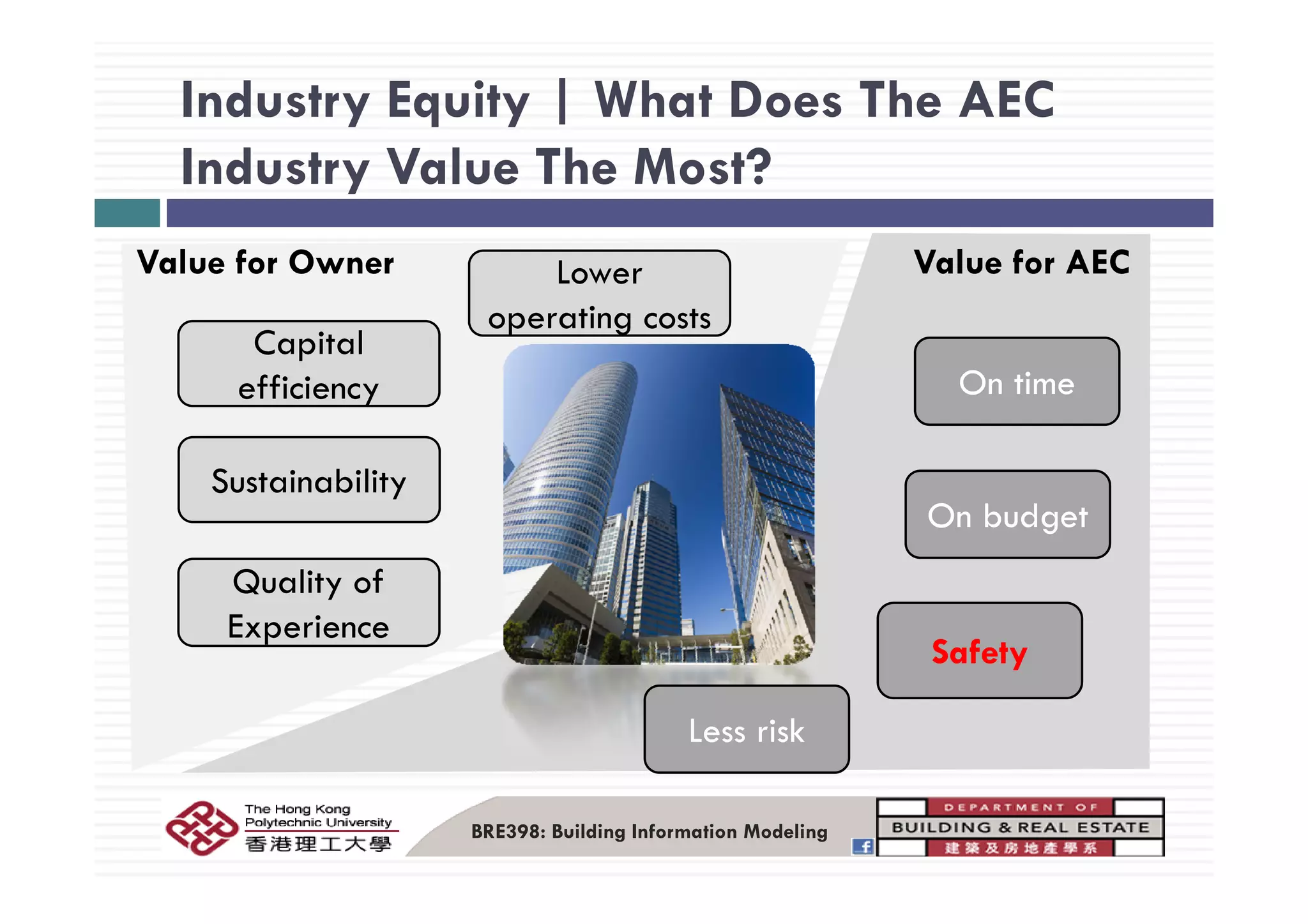

Industry Equity | What Does The AEC
d l hIndustry Value The Most?
V l f O V l f AECValue for Owner Value for AEC
Capital
Lower
operating costs
On time
p
efficiency
On budget
Sustainability
Safety
Quality of
Experience
Less risk
BRE398: Building Information Modeling
TopicsTopics
Building Construction Challenges
Building Information Modeling
3D BIM
Architectural / Structural / MEP Design/ / g
Realistic Simulation
4D BIM4D BIM

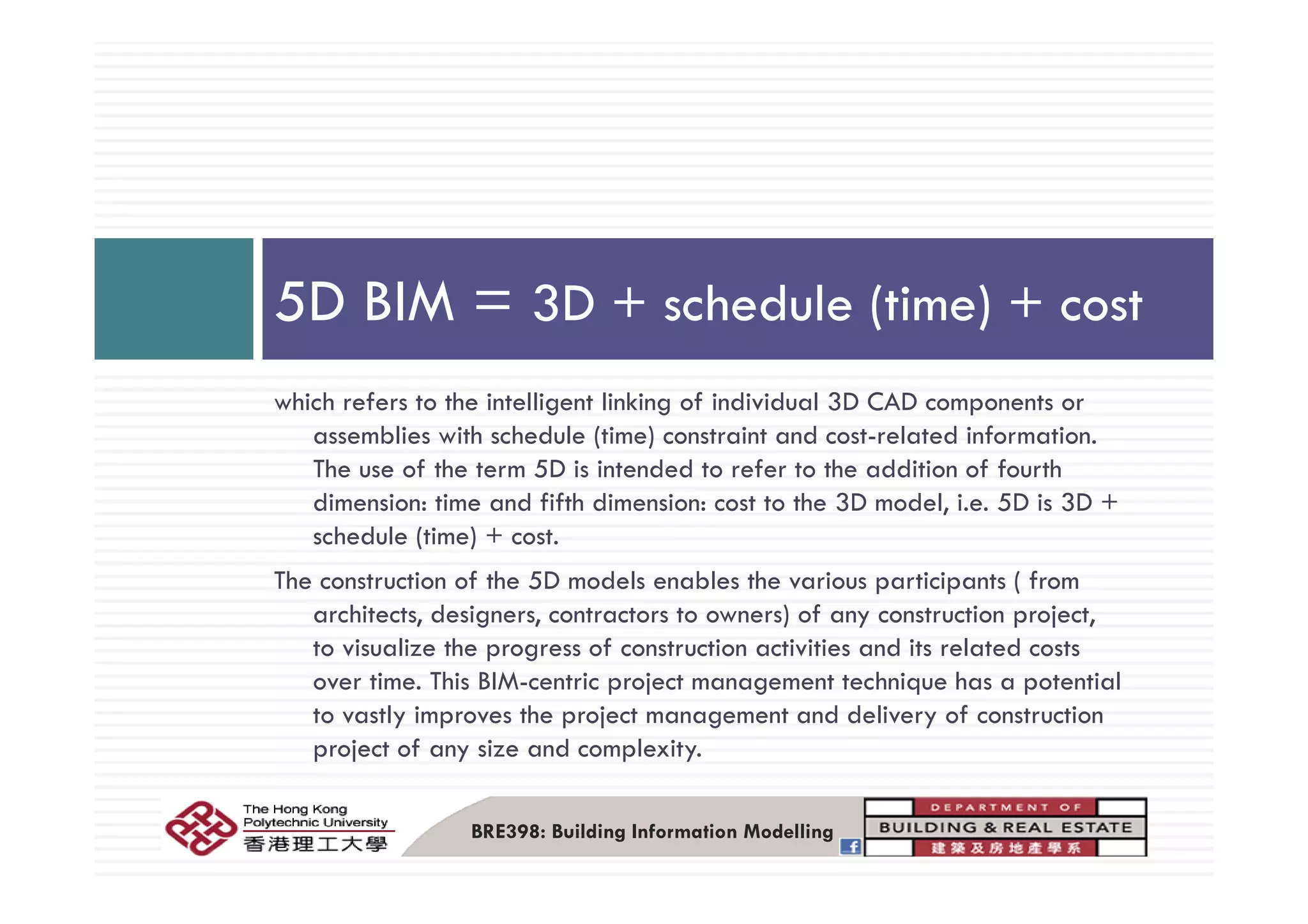

5D BIM

Value of BIM to the industryValue of BIM to the industry
BRE398: Building Information Modeling

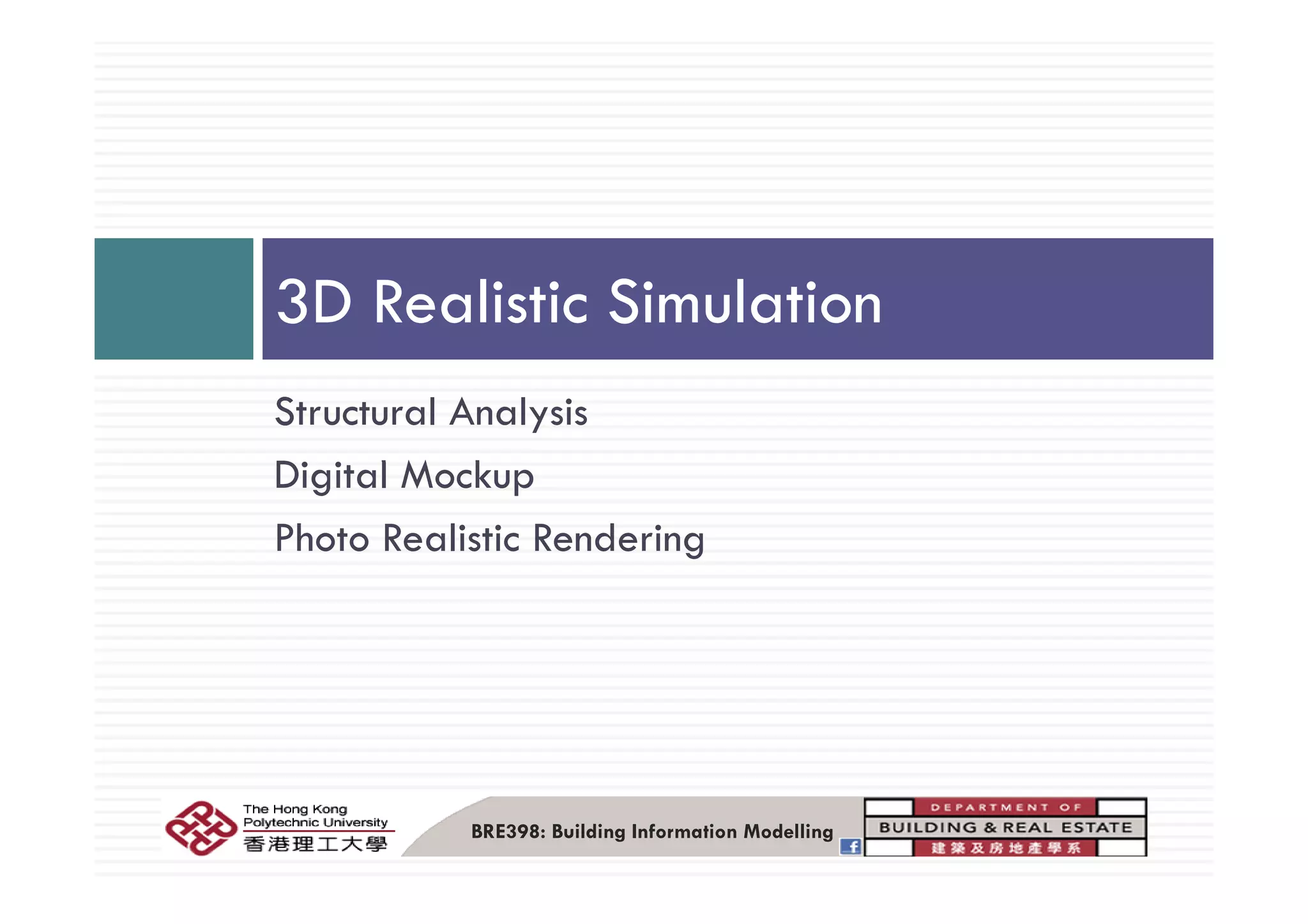

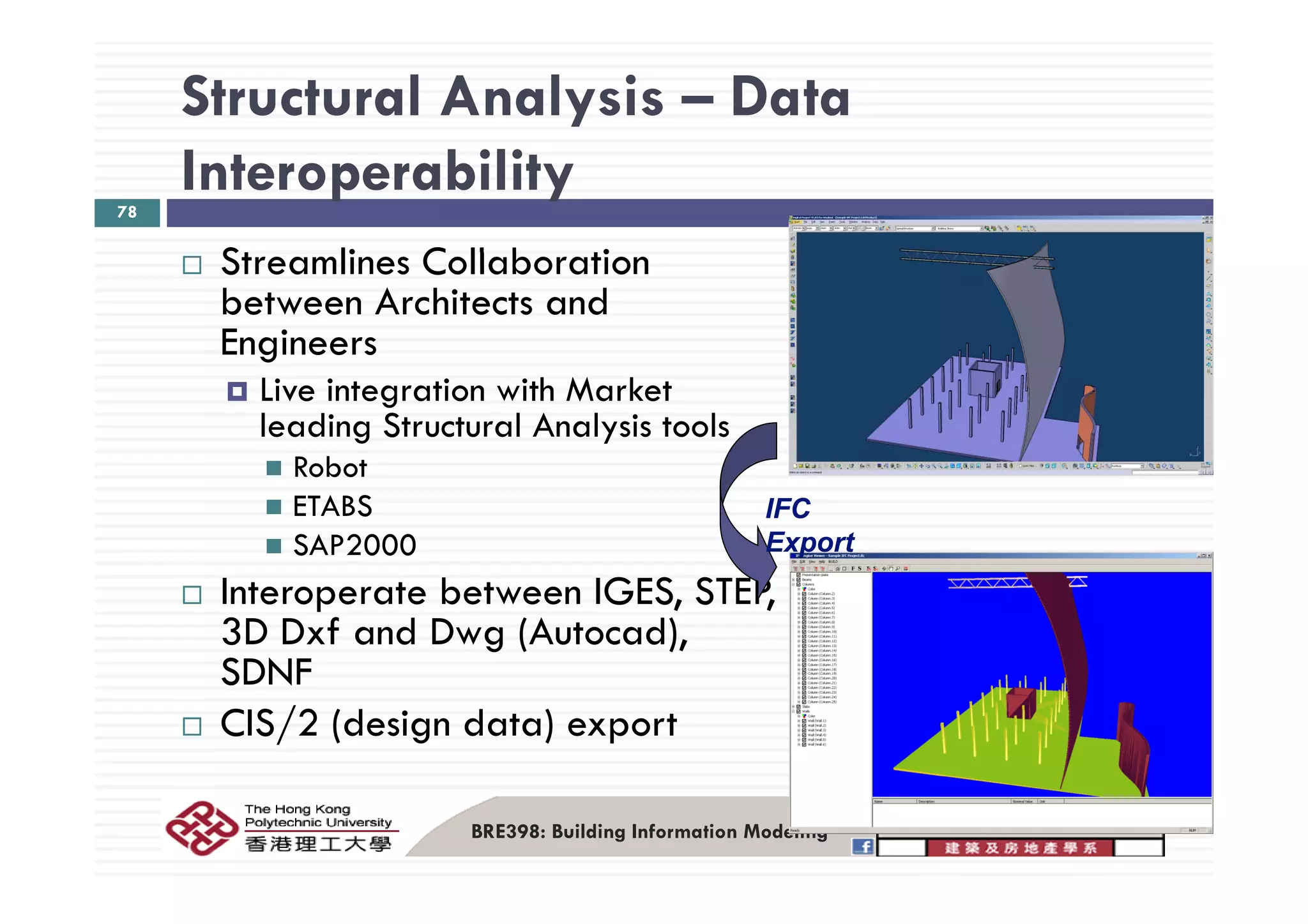

3D BIM
BRE398: Building Information Modelling

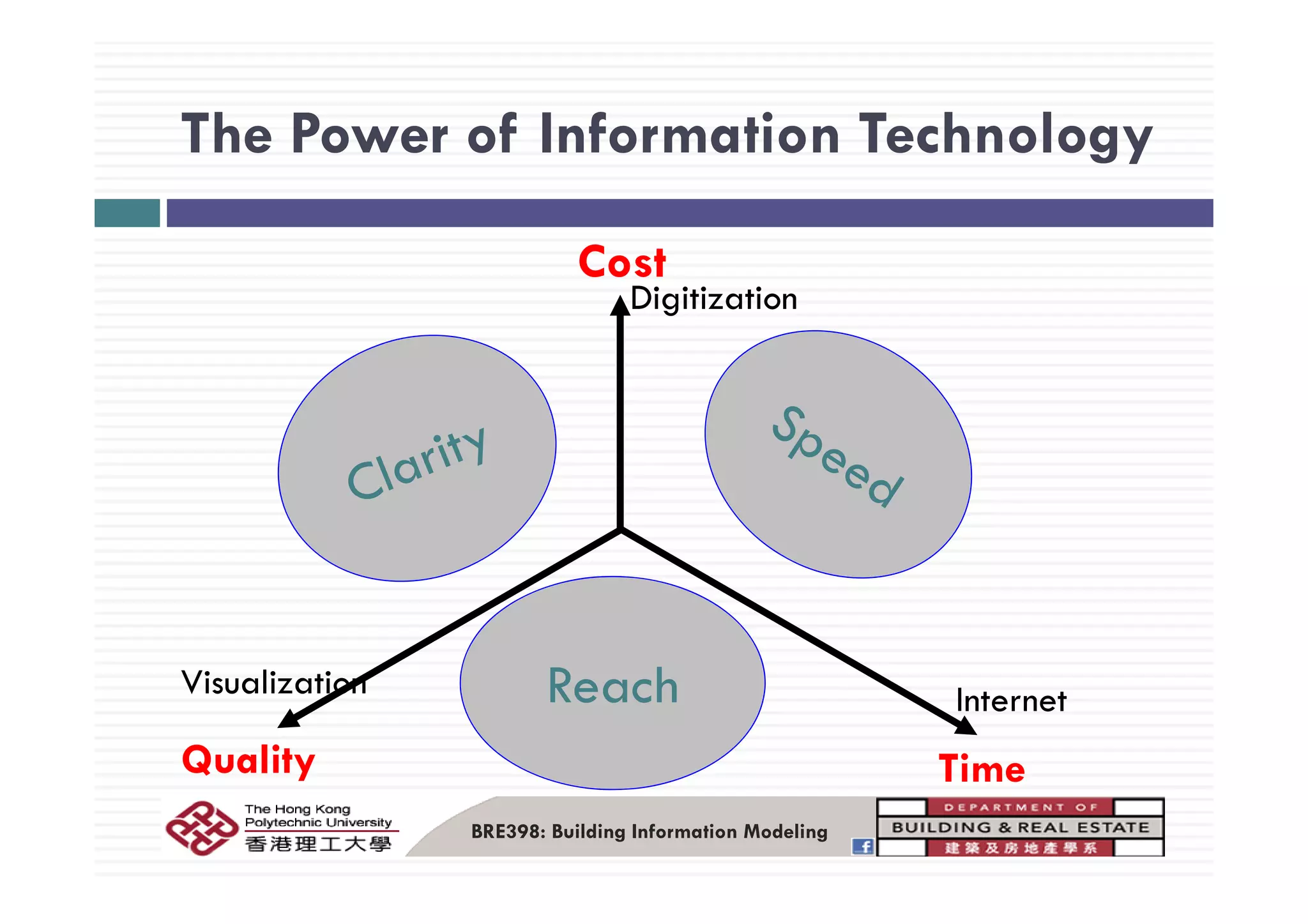

The Power of Information TechnologyThe Power of Information Technology
C t
Digitization
Cost
Vi li i R h InternetVisualization Reach
TimeQuality
BRE398: Building Information Modeling
Timey

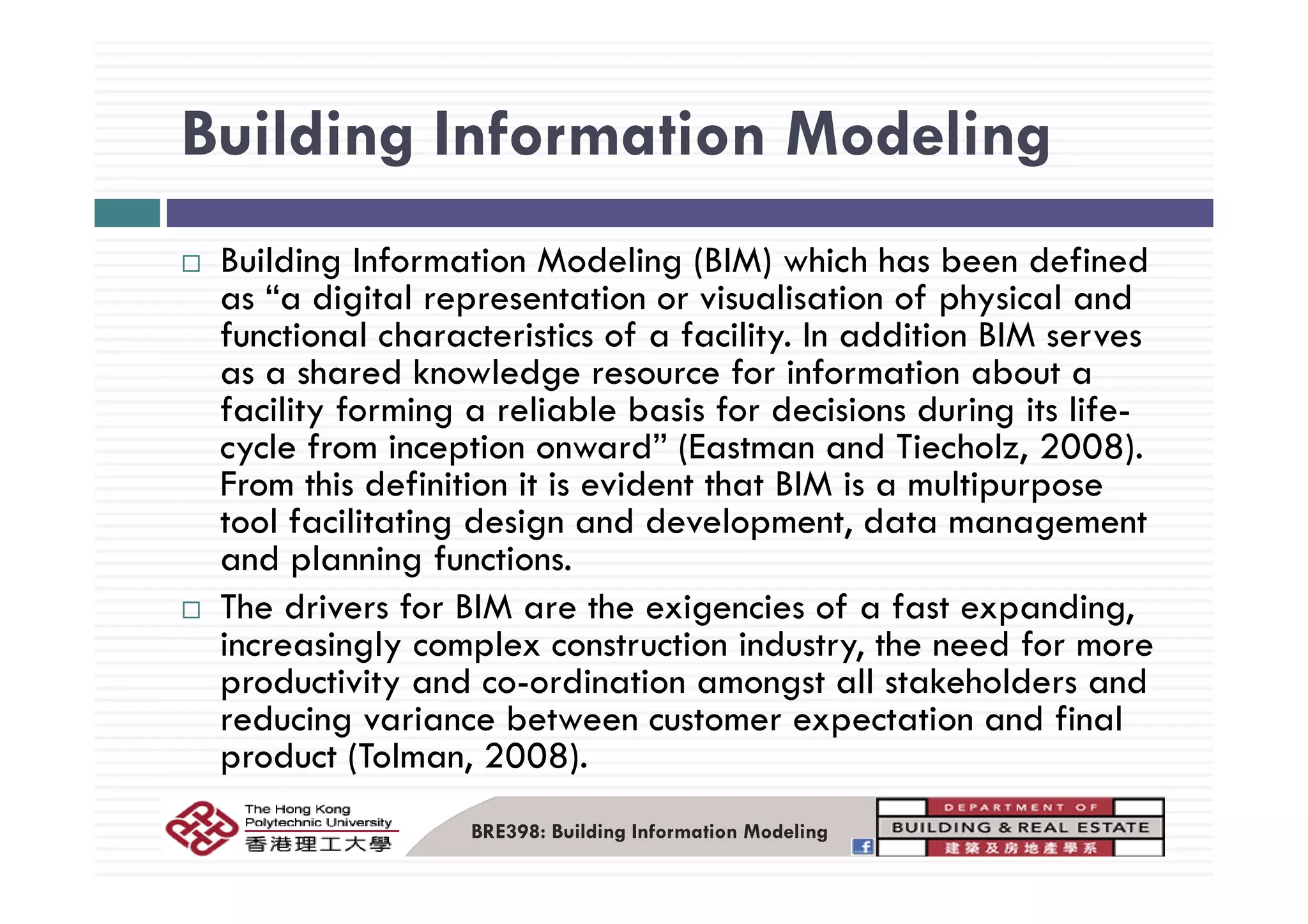

Building Information ModelingBuilding Information Modeling
B ildi I f ti M d li (BIM) hi h h b d fi dBuilding Information Modeling (BIM) which has been defined
as “a digital representation or visualisation of physical and
functional characteristics of a facility. In addition BIM serves
as a shared knowledge resource for information about a
facility forming a reliable basis for decisions during its life-
cycle from inception onward” (Eastman and Tiecholz, 2008).y p ( , )
From this definition it is evident that BIM is a multipurpose
tool facilitating design and development, data management
and planning functions.and planning functions.
The drivers for BIM are the exigencies of a fast expanding,
increasingly complex construction industry, the need for more
d i i d di i ll k h ld dproductivity and co-ordination amongst all stakeholders and
reducing variance between customer expectation and final
product (Tolman, 2008).
BRE398: Building Information Modeling

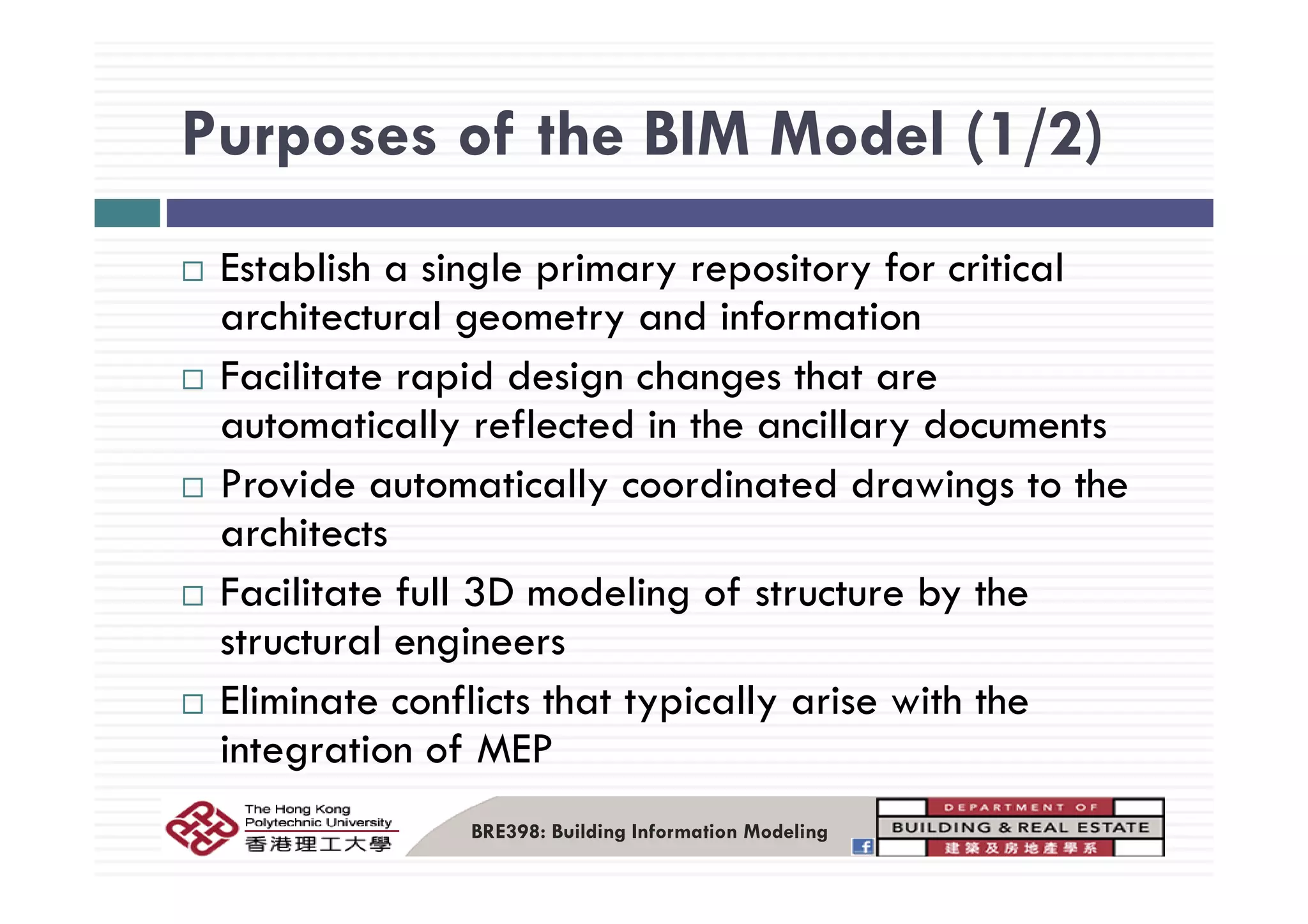

Purposes of the BIM Model (1/2)Purposes of the BIM Model (1/2)
fEstablish a single primary repository for critical
architectural geometry and information
Facilitate rapid design changes that are
automatically reflected in the ancillary documents
Provide automatically coordinated drawings to the
architects
Facilitate full 3D modeling of structure by the
structural engineers
Eliminate conflicts that typically arise with the
integration of MEP
BRE398: Building Information Modeling
Purposes of the BIM Model (2/2)Purposes of the BIM Model (2/2)
Allow automated reporting of certain quantities for
the QS
Provide an easily accessible source of accurate
information for tenderingg
Provide a constructionally accurate rendering model
All t t t i li t tiAllow contractors to visualize construction
sequencing and anticipate possible delays
Become the basis for facilities management work
after construction
BRE398: Building Information Modeling

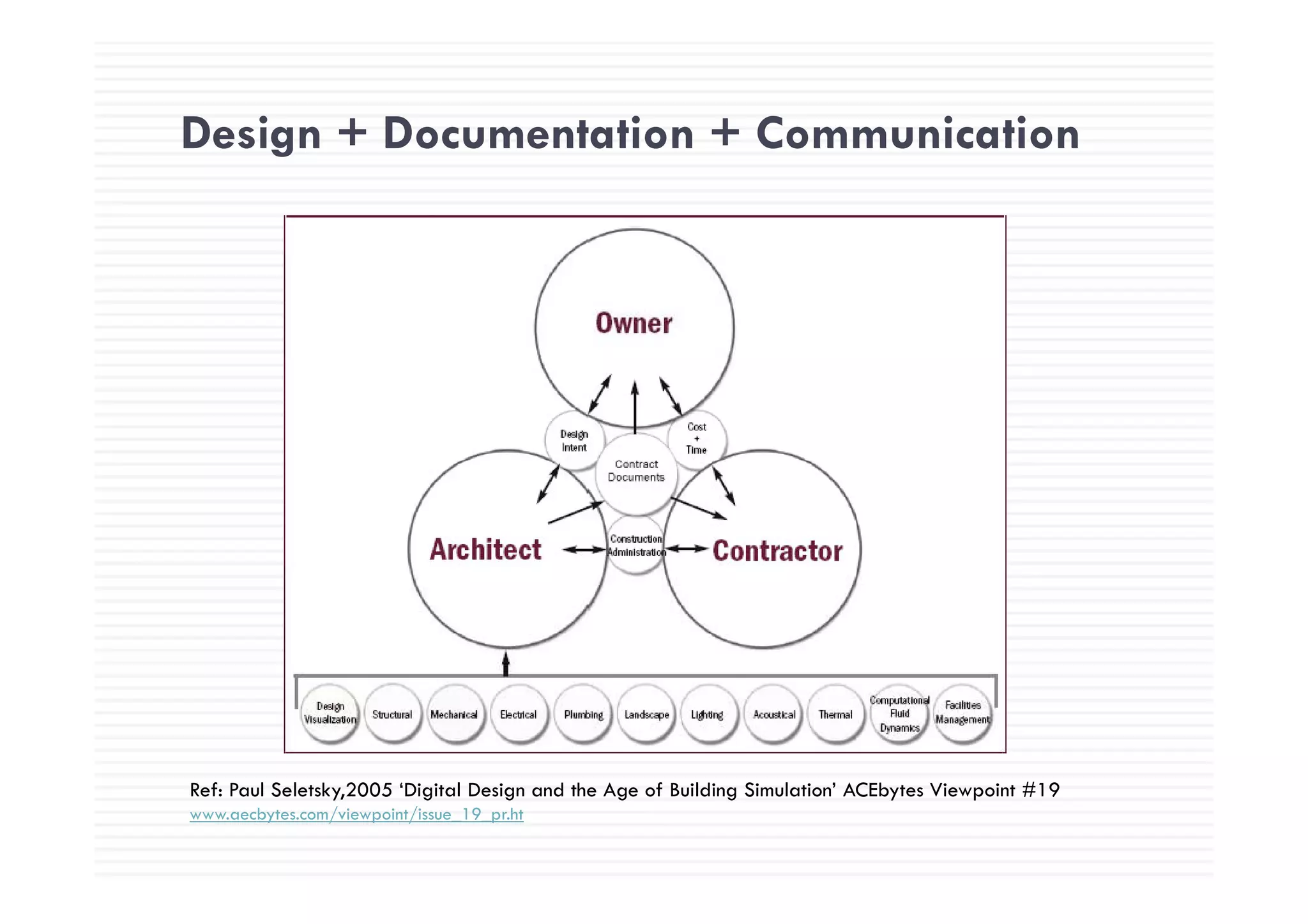

Design + Documentation + CommunicationDesign Documentation Communication
Ref: Paul Seletsky,2005 ‘Digital Design and the Age of Building Simulation’ ACEbytes Viewpoint #19
www.aecbytes.com/viewpoint/issue_19_pr.ht

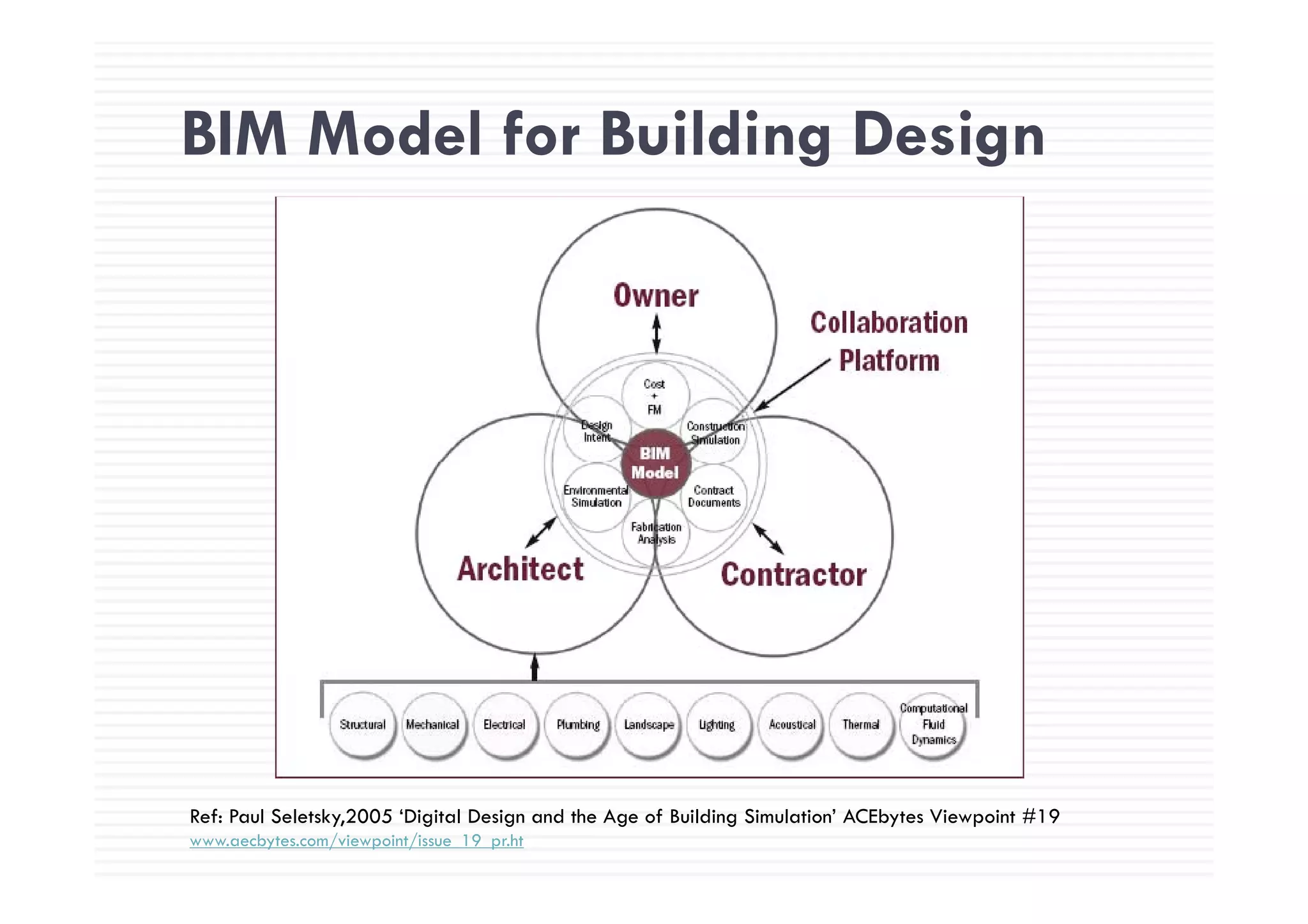

BIM Model for Building DesignBIM Model for Building Design
Ref: Paul Seletsky,2005 ‘Digital Design and the Age of Building Simulation’ ACEbytes Viewpoint #19
www.aecbytes.com/viewpoint/issue_19_pr.ht

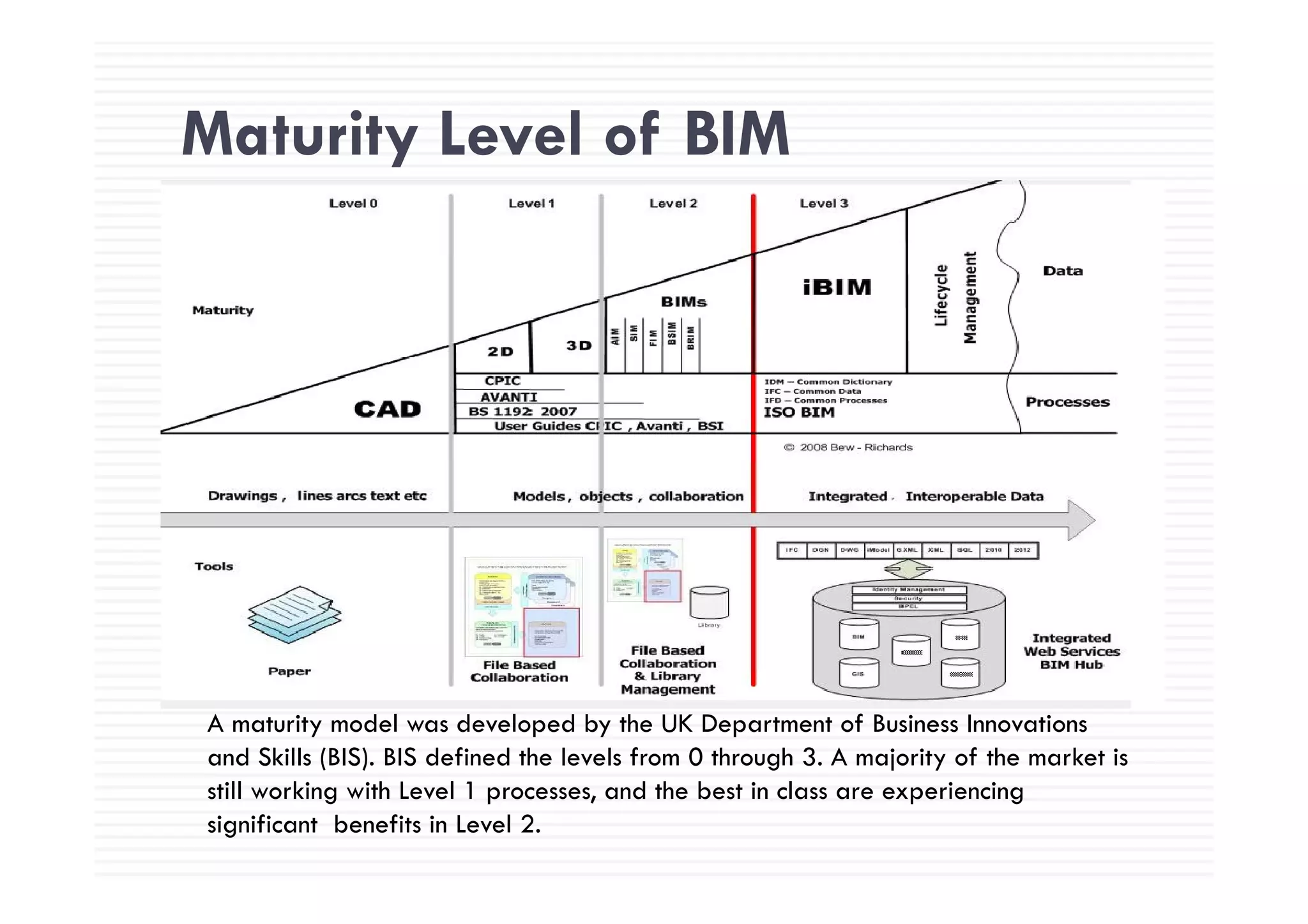

Maturity Level of BIMMaturity Level of BIM
A maturity model was developed by the UK Department of Business Innovations
and Skills (BIS). BIS defined the levels from 0 through 3. A majority of the market is
still working with Level 1 processes, and the best in class are experiencing
significant benefits in Level 2.
Economic Functional Working Tender & Construction + O

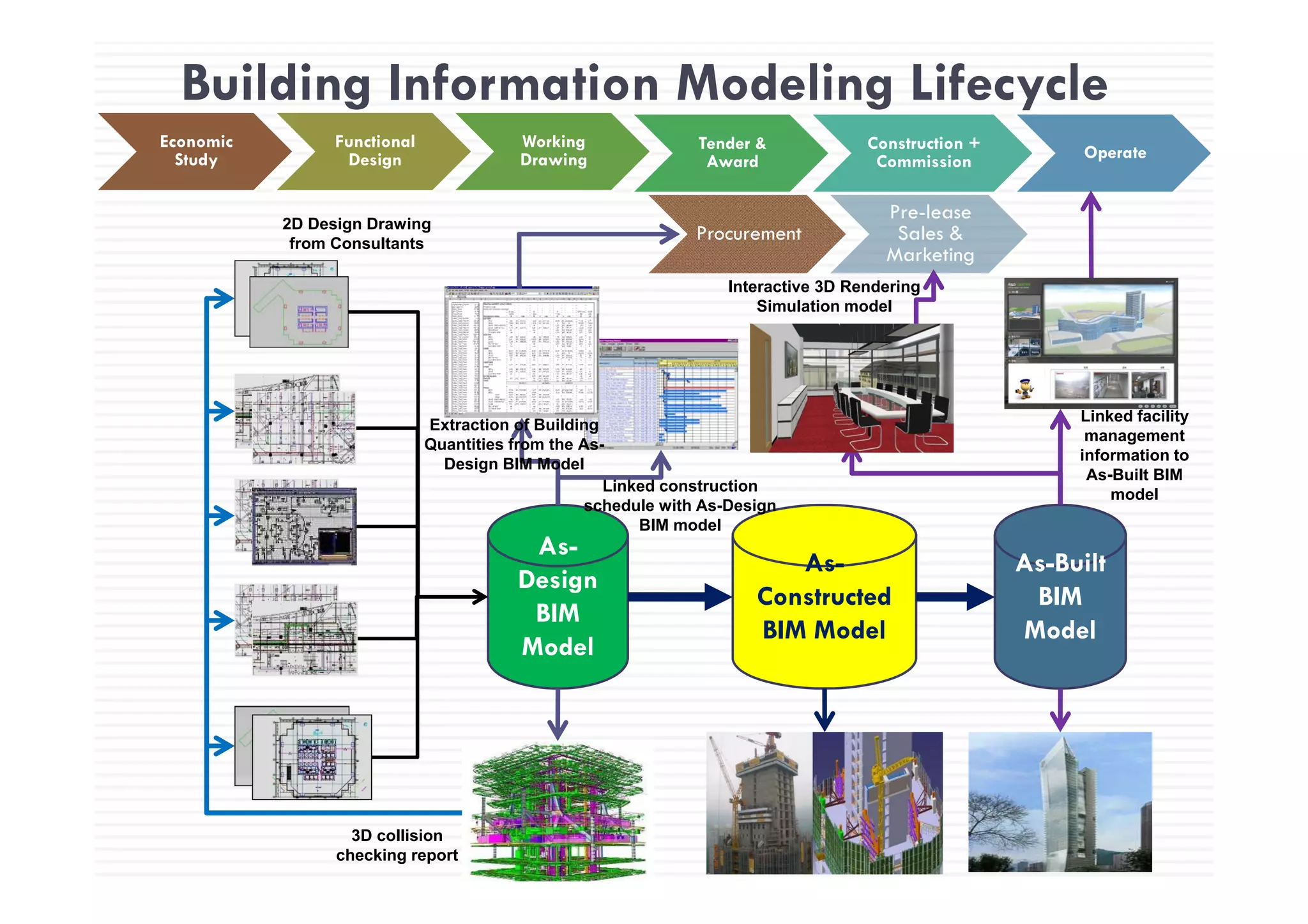

Building Information Modeling Lifecycle
Study Design
g
Drawing
Tender &
Award
Construction +
Commission Operate
Procurement
Pre-lease
Sales &
Marketing
2D Design Drawing
from Consultants
Marketing
Interactive 3D Rendering
Simulation model
Extraction of Building
Quantities from the As-
Design BIM Model
Linked facility
management
information to
As-
As- As-Built
Design BIM Model
Linked construction
schedule with As-Design
BIM model
As-Built BIM
model
Design
BIM
Model
As-
Constructed
BIM Model
As-Built
BIM
Model
3D collision
checking report
Quebec Hydro Power Plant
33
BRE398: Building Information ModelingMercier_Demo_AnimatedwithText.avi
BIM Solutions
Bridging the gap between concept design & construction

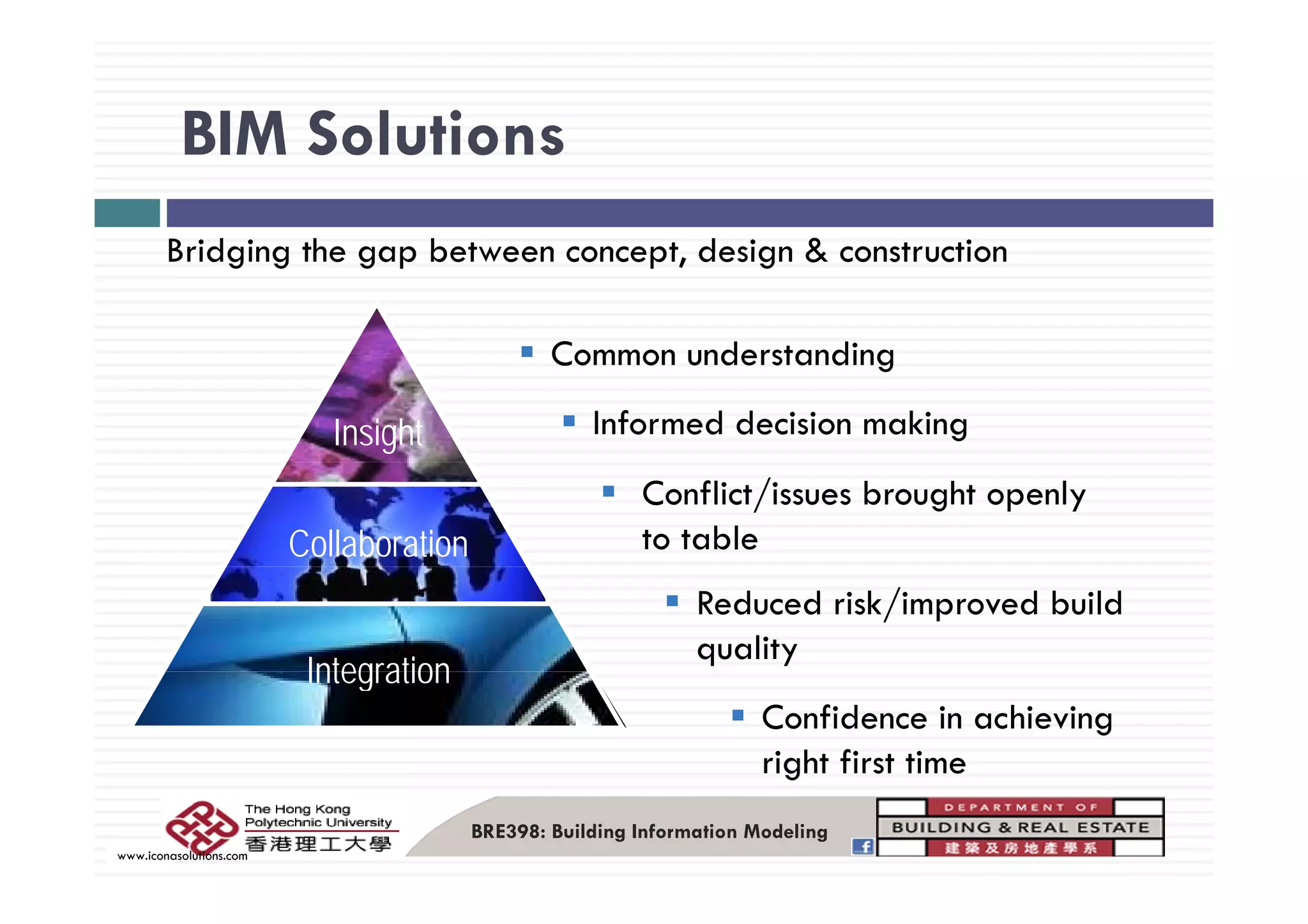

BIM Solutions
Common understanding
Bridging the gap between concept, design & construction
Common understanding
Informed decision makingInsight
Conflict/issues brought openly
to tableCollaboration
Reduced risk/improved build
quality
Integration
Confidence in achieving
right first time
Integration
BRE398: Building Information Modeling
www.iconasolutions.com
g

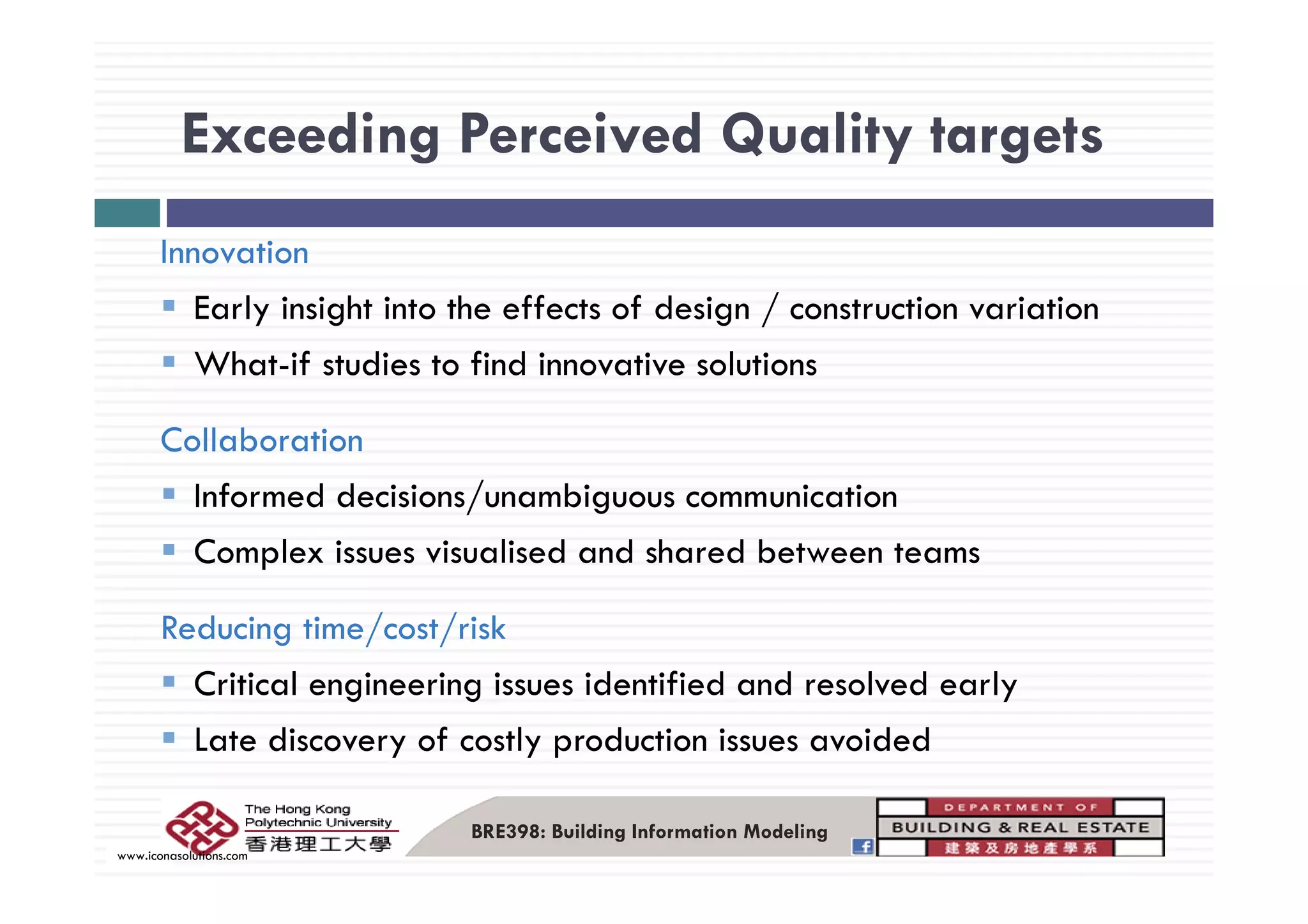

Exceeding Perceived Quality targets
Innovation
Exceeding Perceived Quality targets
Innovation
Early insight into the effects of design / construction variation
Wh t if t di t fi d i ti l tiWhat-if studies to find innovative solutions
Collaboration
Informed decisions/unambiguous communication
Complex issues visualised and shared between teamsp
Reducing time/cost/risk
C l d f d d l d lCritical engineering issues identified and resolved early
Late discovery of costly production issues avoided
BRE398: Building Information Modeling
www.iconasolutions.com
A hit t l / St t l / MEPArchitectural / Structural / MEP
Design
3D Complex surface design
Architectural and structural design
Design
Architectural and structural design
MEP design
Knowledge driven designg g
BRE398: Building Information Modelling
BIM Data StructuringBIM Data Structuring
39
Assembled by a collection of files representing the physicalAssembled by a collection of files, representing the physical
differentiation of building components
Each consultant designs on respective component individually
and concurrently
ArchitectArchitect
B. S.
Engineer
Structural Engineer
BRE398: Building Information Modeling

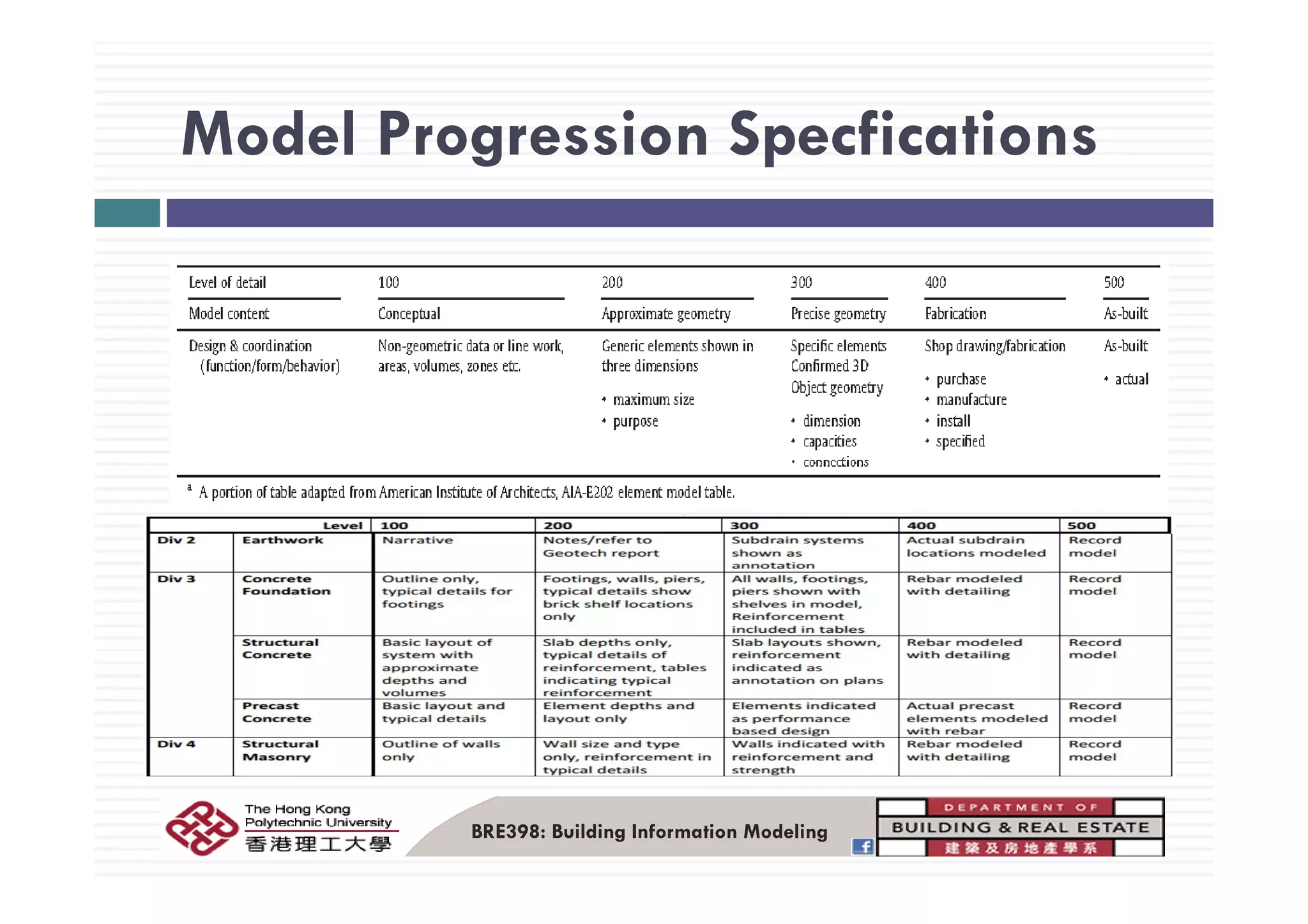

Model Progression SpecficationsModel Progression Specfications
BRE398: Building Information Modeling
3D Complex Surface Design
41
3D Complex Surface Design
All type of surface elements: from stylist to final surfaces
ready for manufacturingready for manufacturing
Memphis Canopy structure -p py
Freeform metal finishes to
manufacturing
Building envelope and associated
structural design
Complex Surface Design
42
Complex Surface Design
Project: London 2012 Olympic Games Aquatic Centre
Architect: Zaha Hadid
MTECH Confidential– 2005 Page
43

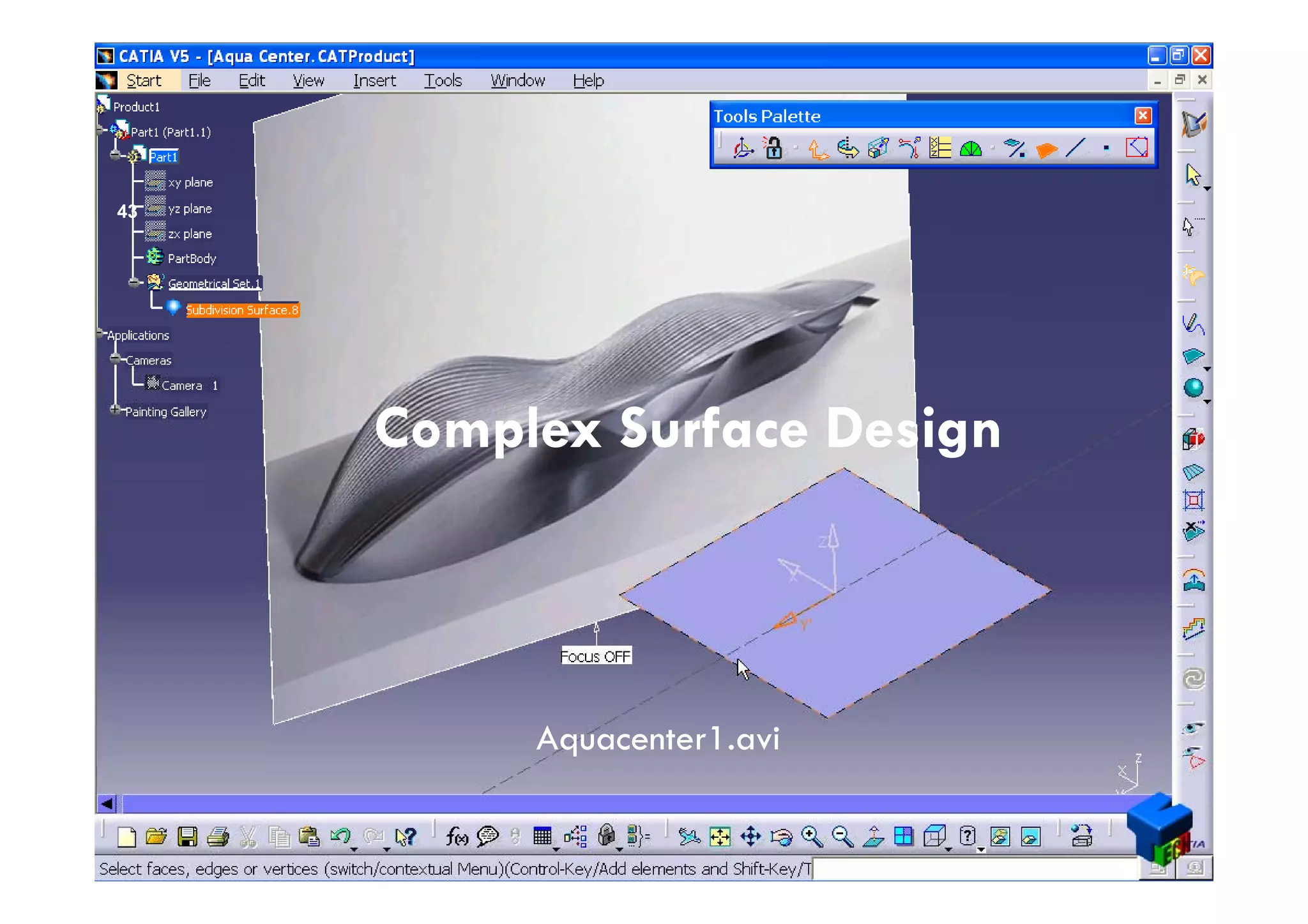

Complex Surface DesignComplex Surface Design
Aquacenter1.aviAquacenter1.avi
Parametric design
44
a a e c des g
Architectural and structural design
from2Dto3D-short.avi
MTECH Confidential– 2005 Page
Life-Build DesignLife Build Design
BRE398: Building Information Management
Values of BIM on DesignValues of BIM on Design
BIM i t i t 2D d 3D d iBIM is a great improvement over 2D and 3D drawings
since it enables designers to view the building from all
angles (Bentley, 2009). This enables identification ofg ( y, )
any errors at an early stage which can then be
corrected avoiding costly rework.
O f h f i li i f BIM i i i fOne of the functionalities of BIM is incorporation of
parametric design elements. Changes, additions or
editions in any one parameter results in simultaneouseditions in any one parameter results in simultaneous
reconfiguration of all other elements involved in the
design including sectional and elevation dimensions, raw
material requirements cost of production andmaterial requirements, cost of production and
construction schedules and timelines (Emery, 2008)
BRE398: Building Information Modeling
MEP Design
BRE398: Building Information Modelling
Process & Systems Design
48
Process & Systems Design
0) P li i L t
4) Process Planning
Reaction planning0) Preliminary Layout
Import Terrain data
Building and Main equipment
General Arrangement
Preliminary weight estimates
Cost Estimates
Reaction planning
Assembly hierarchy
Association of resources
Extract manufacturing document
1) Basic Design
Define major system allocation
Equipment Lists
Preliminary BOM estimates
Preliminary Weight estimates
Pressure lose calculations
2) Detail Design
Add secondary hangers & support
Finish the detailing
Define reaction spool
3) Manufacturing Deliverables
Extract Mfg. Documents
Assembly drawings
Bill of Materials
Equipment & Systems Design
Ventilation systems
HVAC
Equipment & Systems Design
Electrical
Cabling
Conceptual Layout
System Routing
Raceway & Conduit
Drainage & Firing systems
Piping
y
Hangers

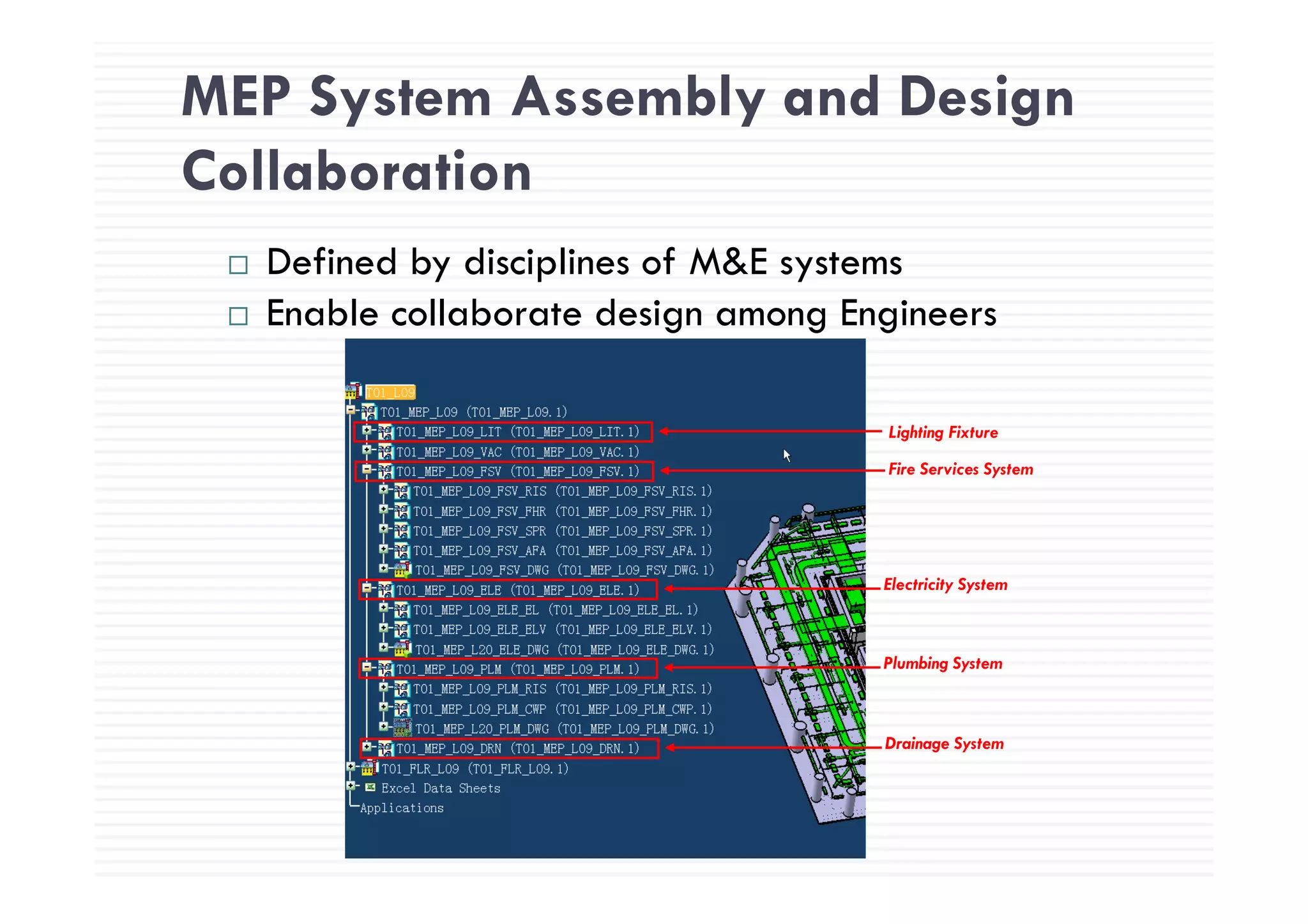

MEP System Assembly and Design
Collaboration
D fi d b di i li f M&E tDefined by disciplines of M&E systems
Enable collaborate design among Engineers
Lighting Fixture
Fire Services System
Electricity System
Plumbing Systemg y
Drainage System

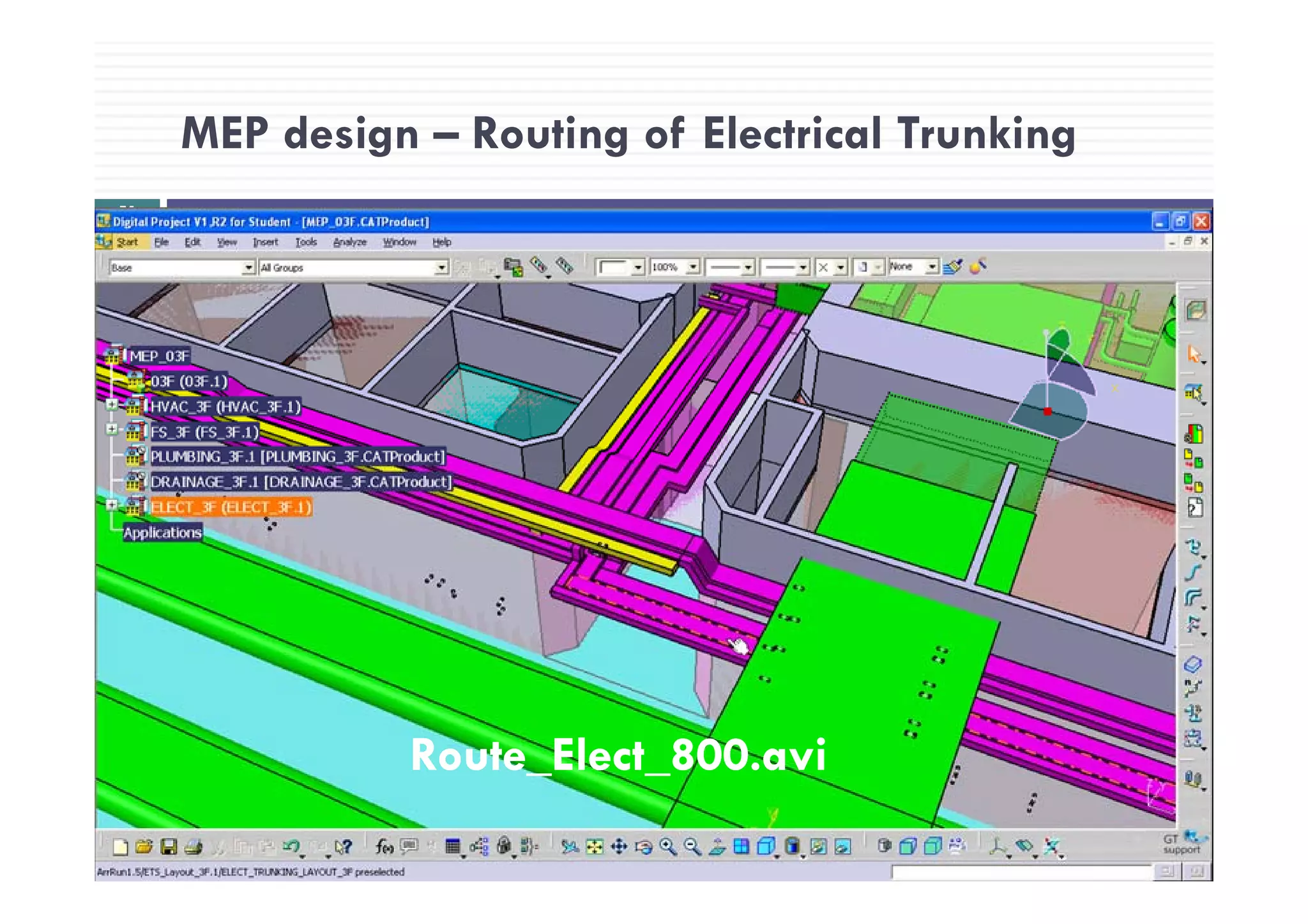

MEP design – Routing of Electrical TrunkingMEP design Routing of Electrical Trunking
51
Route_Elect_800.aviRoute_Elect_800.avi
BRE398: Building Information Modeling

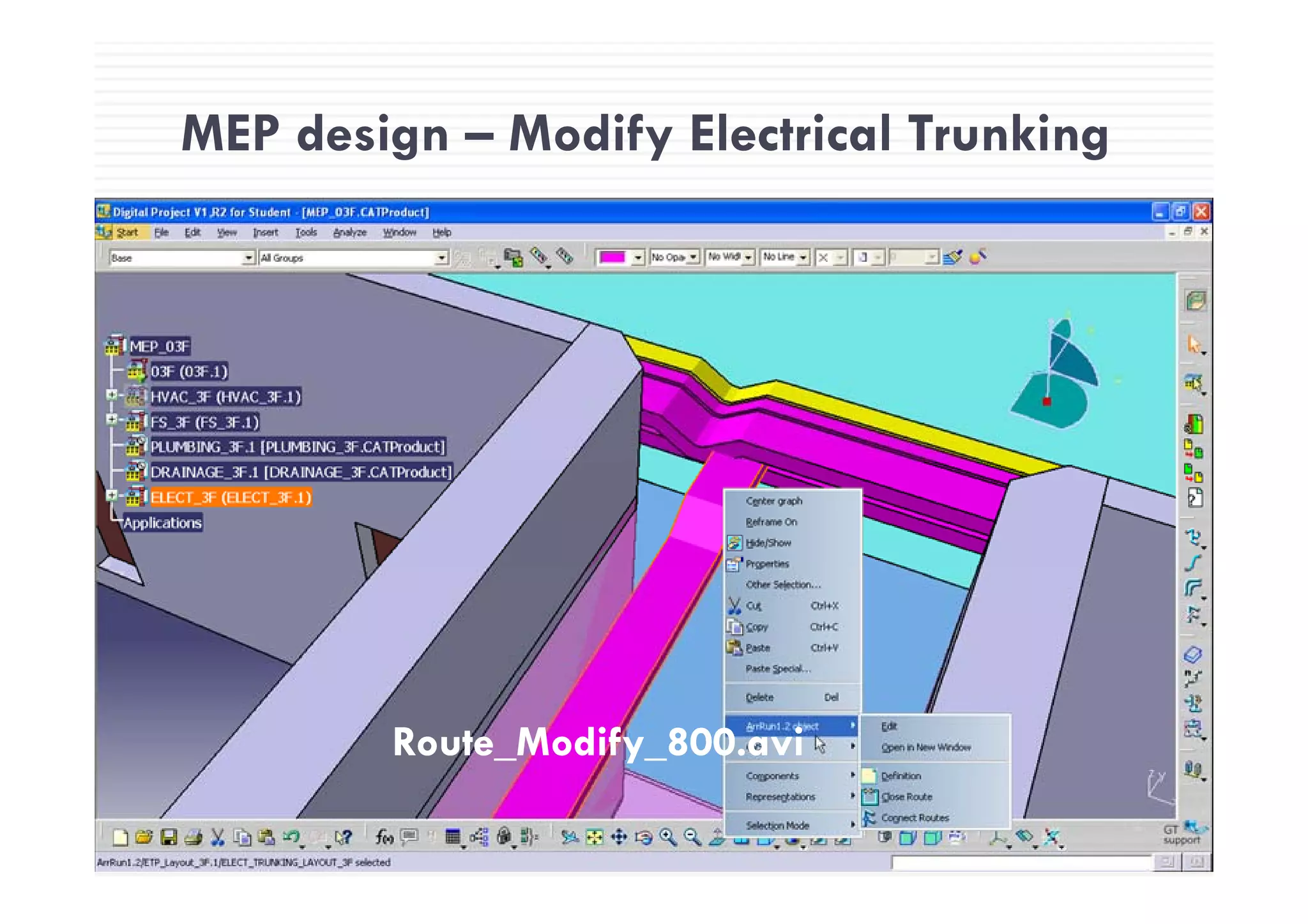

MEP design – Modify Electrical TrunkingMEP design Modify Electrical Trunking
Route_Modify_800.aviRoute_Modify_800.avi

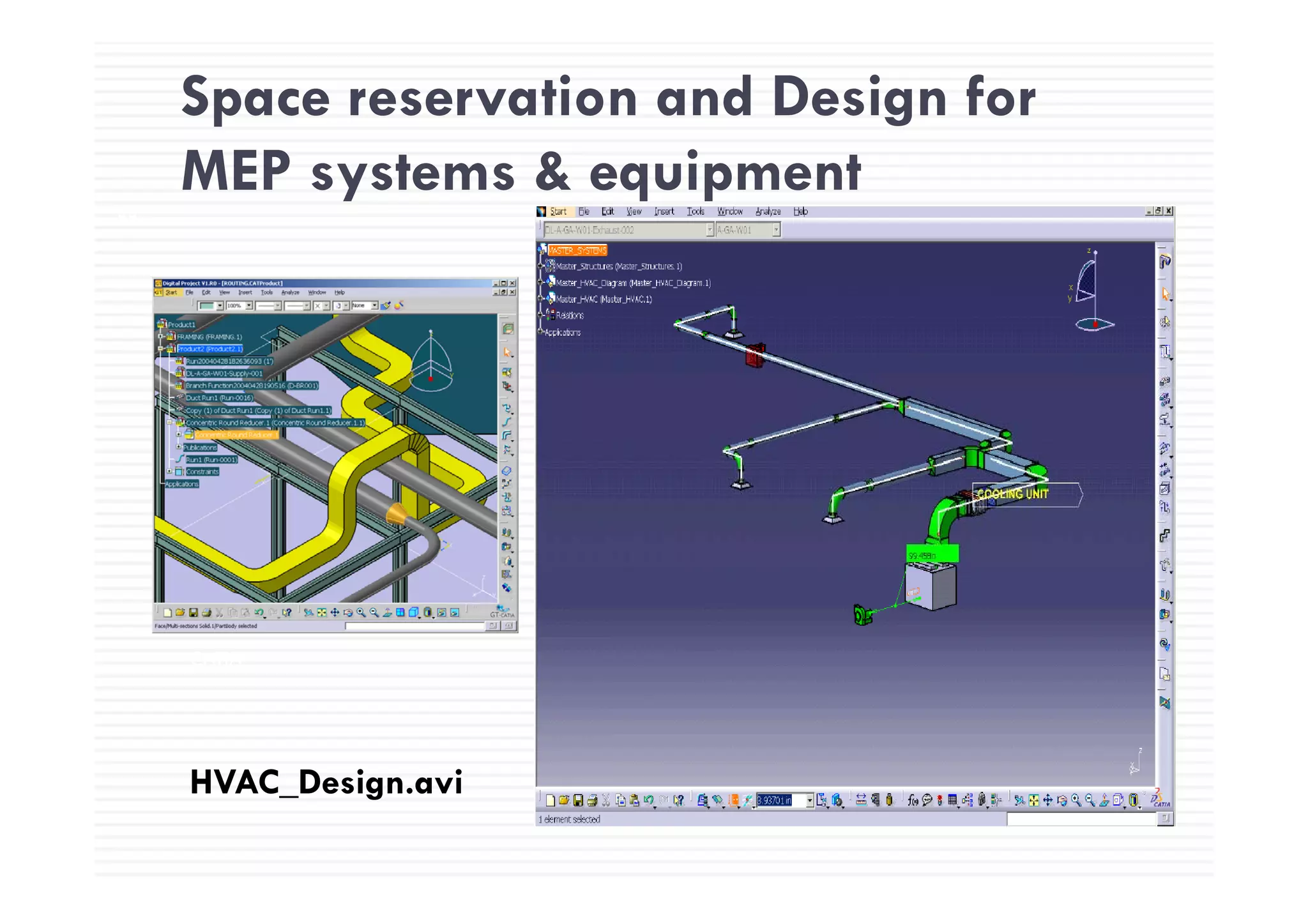

Space reservation and Design for
53
MEP systems & equipment
XSteel
CATIA
HVAC D i iHVAC_Design.avi

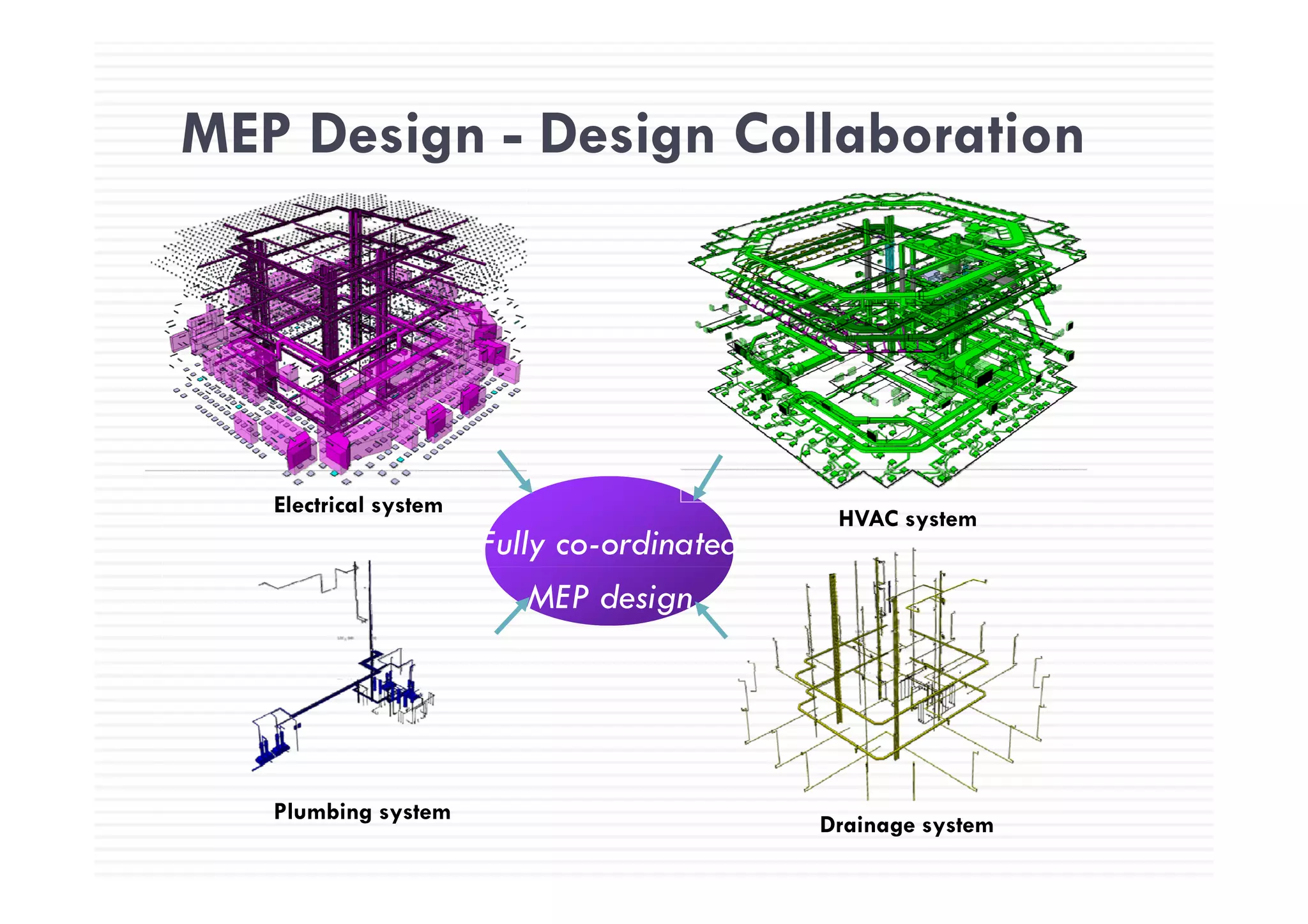

MEP Design - Design CollaborationMEP Design Design Collaboration
HVAC system
Fully co-ordinated
Electrical system
MEP design
Plumbing system
Drainage system

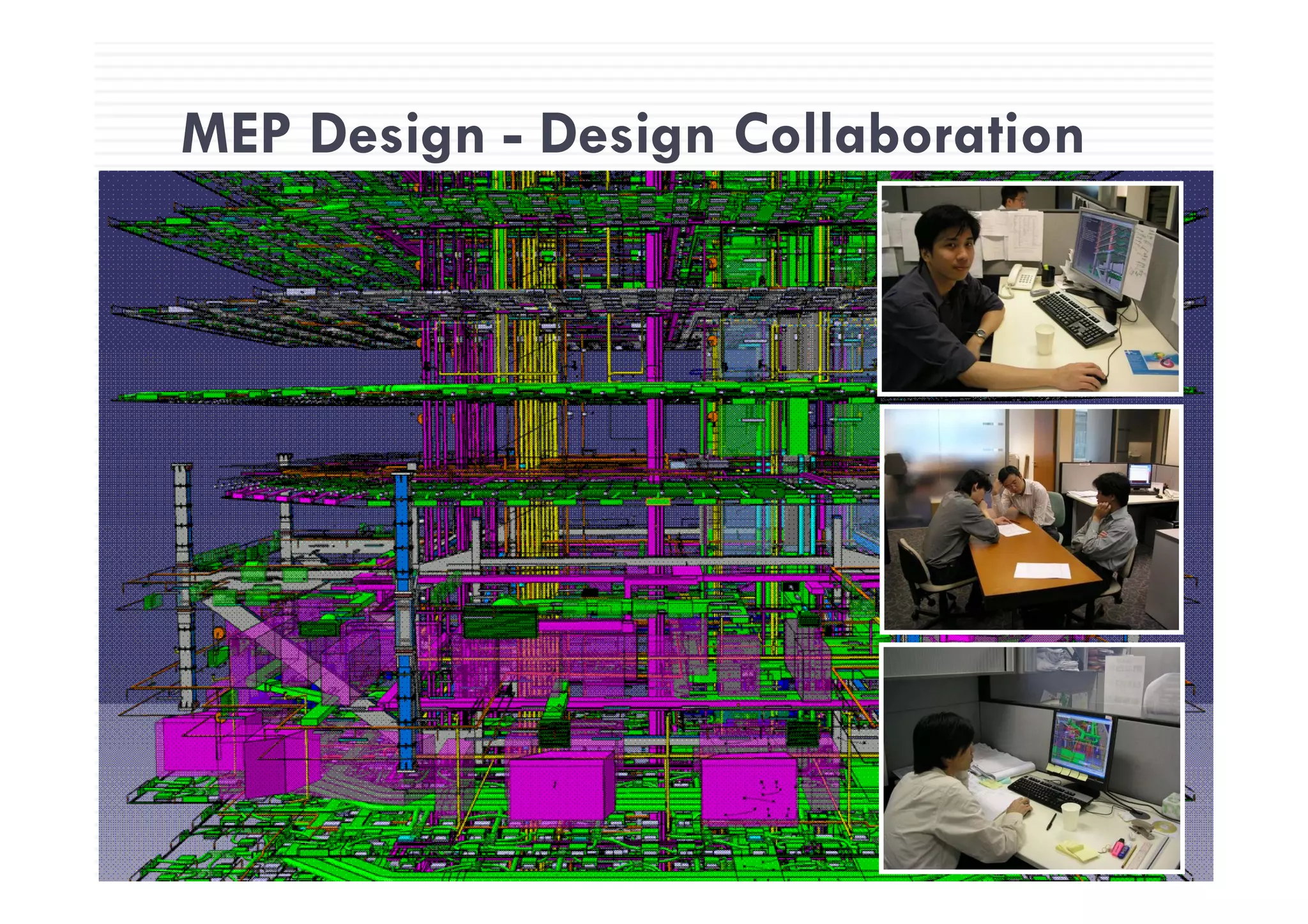

MEP Design - Design Collaboration
55
MEP Design Design Collaboration
MTECH Confidential– 2005 Page
机电系统同步設計 & 干涉检查

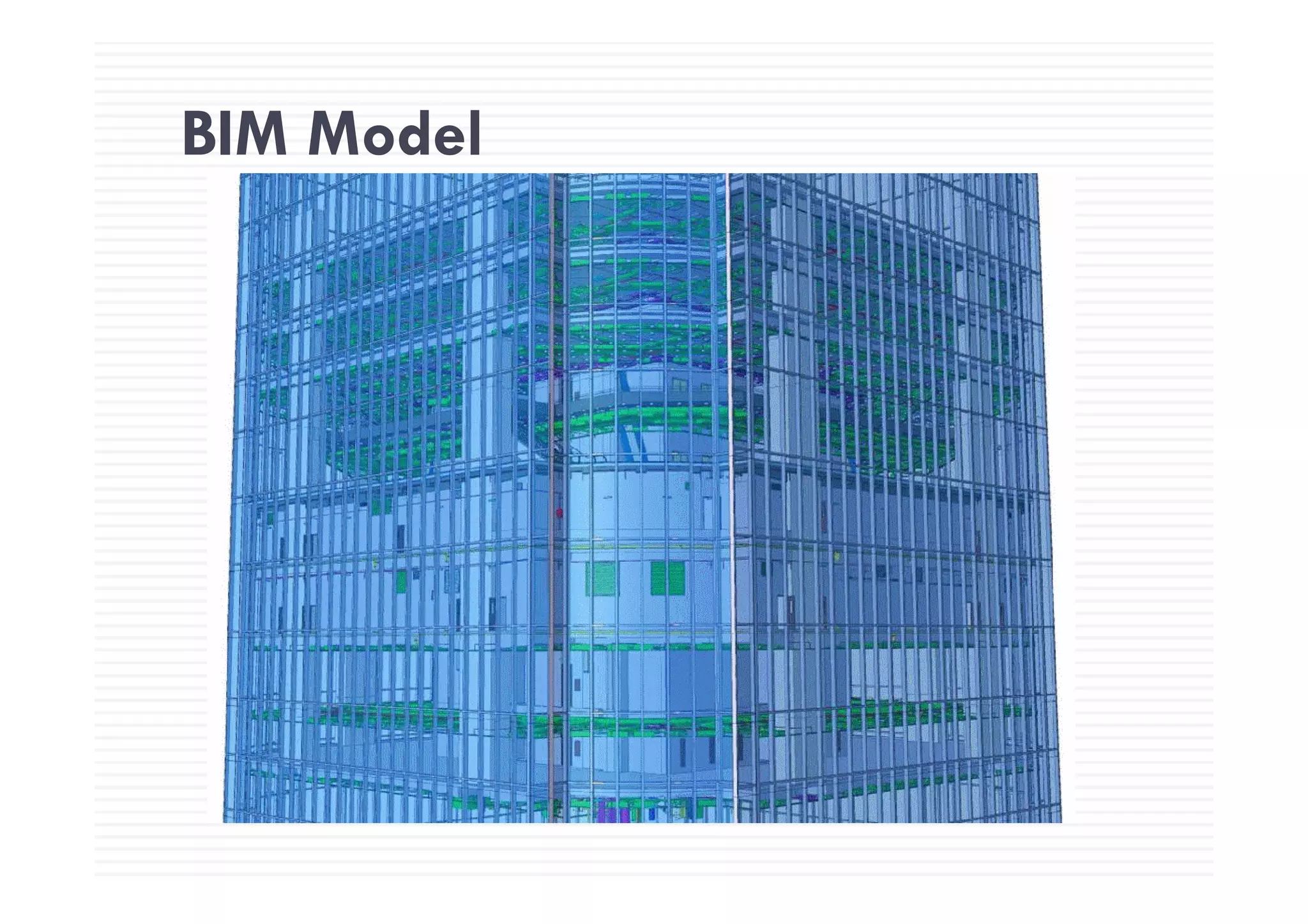

BIM ModelBIM Model
57

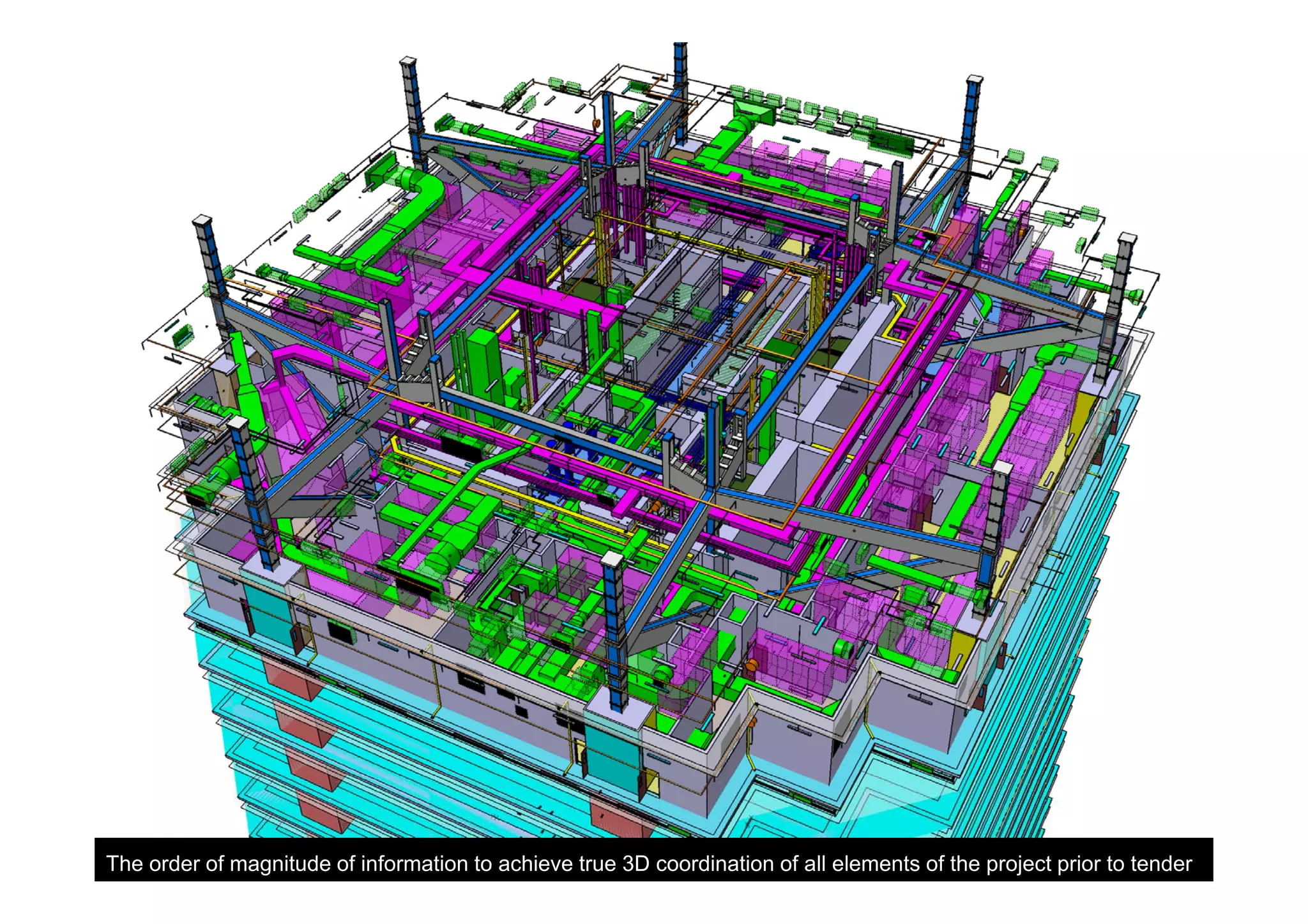

BRE398: Building Information ModelingMTECH Confidential– 2005 Page
The order of magnitude of information to achieve true 3D coordination of all elements of the project prior to tender

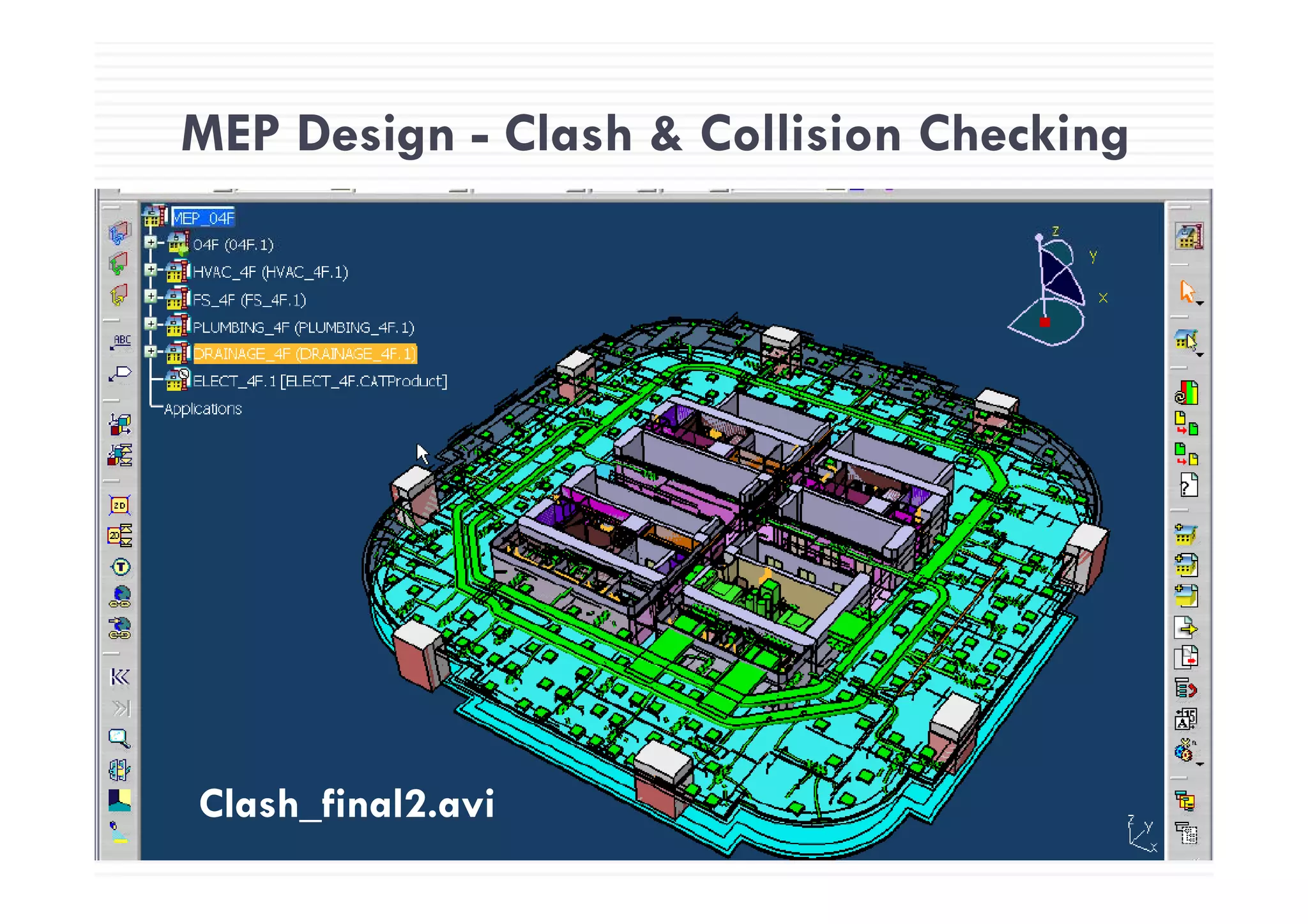

MEP Design - Clash & Collision CheckingMEP Design Clash & Collision Checking
Clash_final2.aviClash_final2.avi

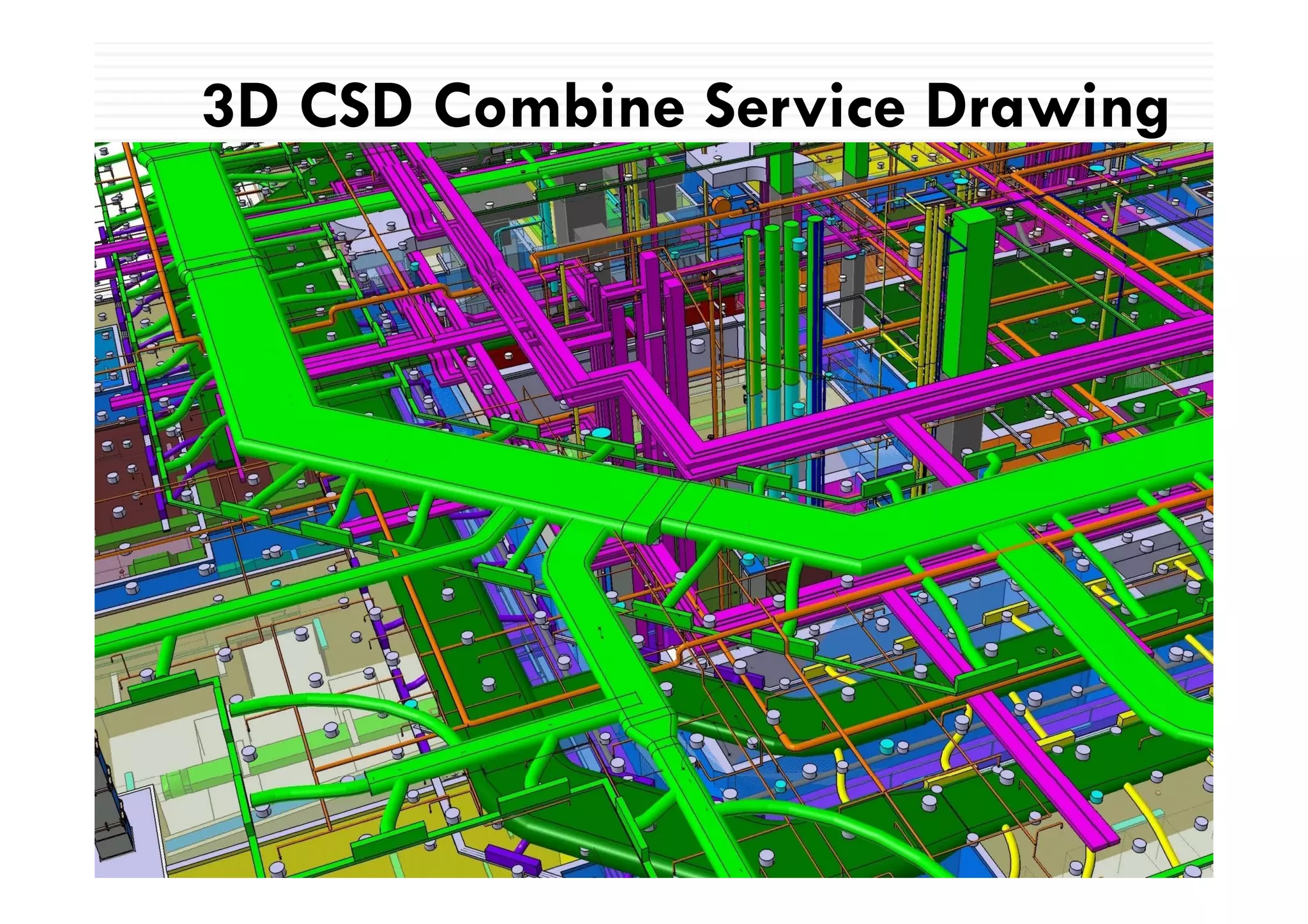

3D CSD Combine Service Drawing
59
MTECH Confidential– 2005 Page

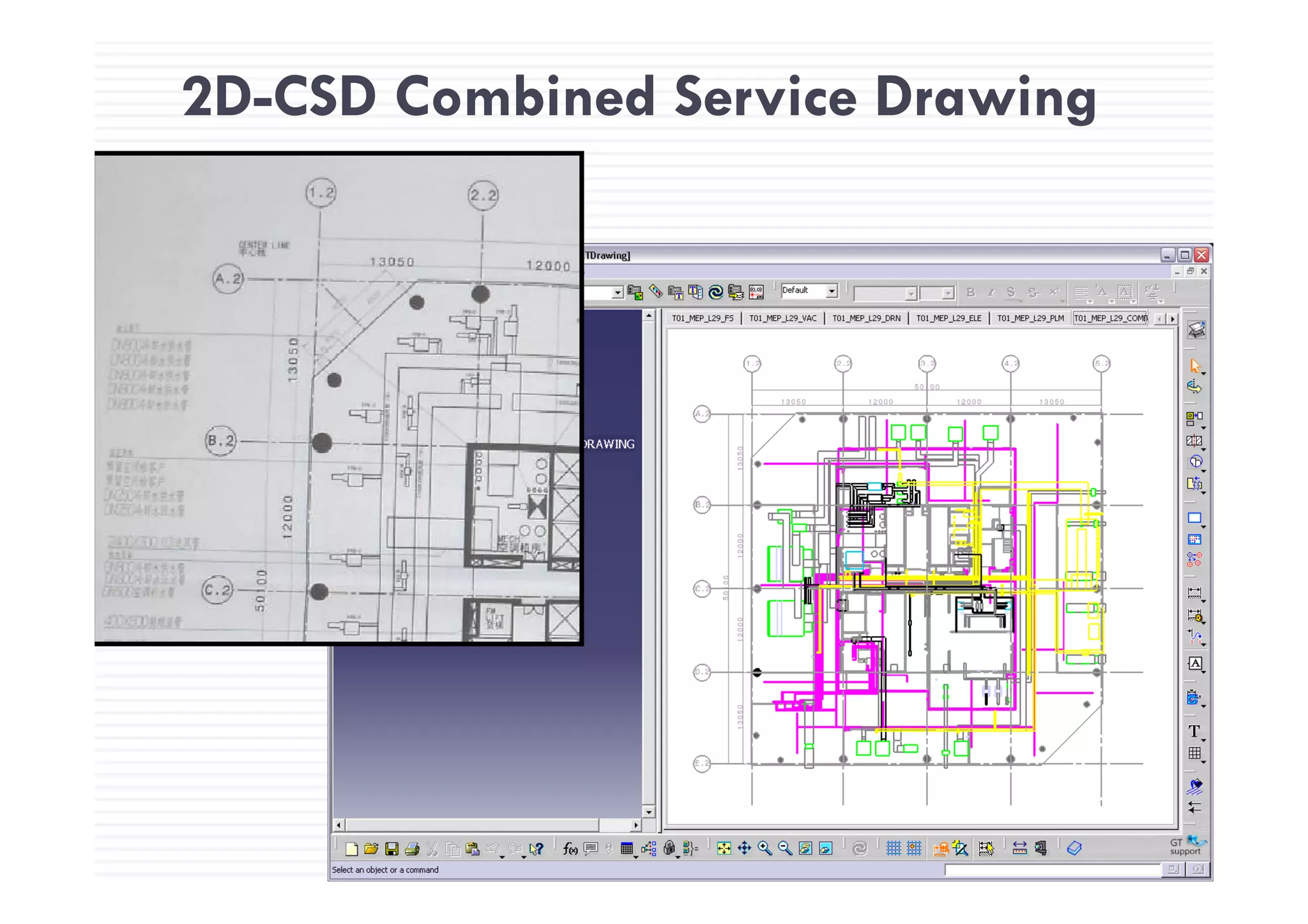

2D-CSD Combined Service Drawing
60
MTECH Confidential– 2005 Page

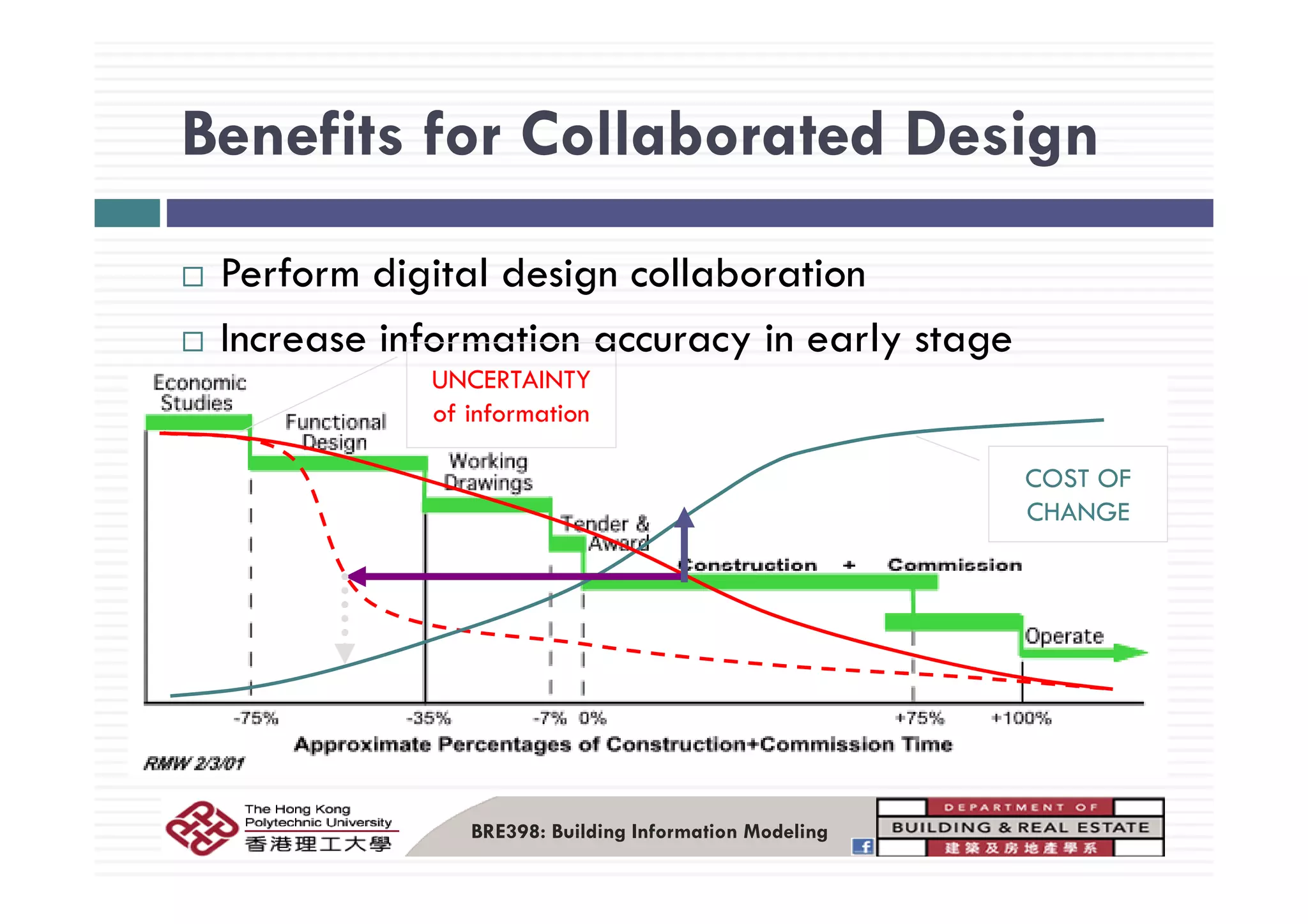

Benefits for Collaborated DesignBenefits for Collaborated Design
Perform digital design collaboration
Increase information accuracy in early stagey y g
UNCERTAINTY
of information
COST OF
CHANGE
BRE398: Building Information Modeling

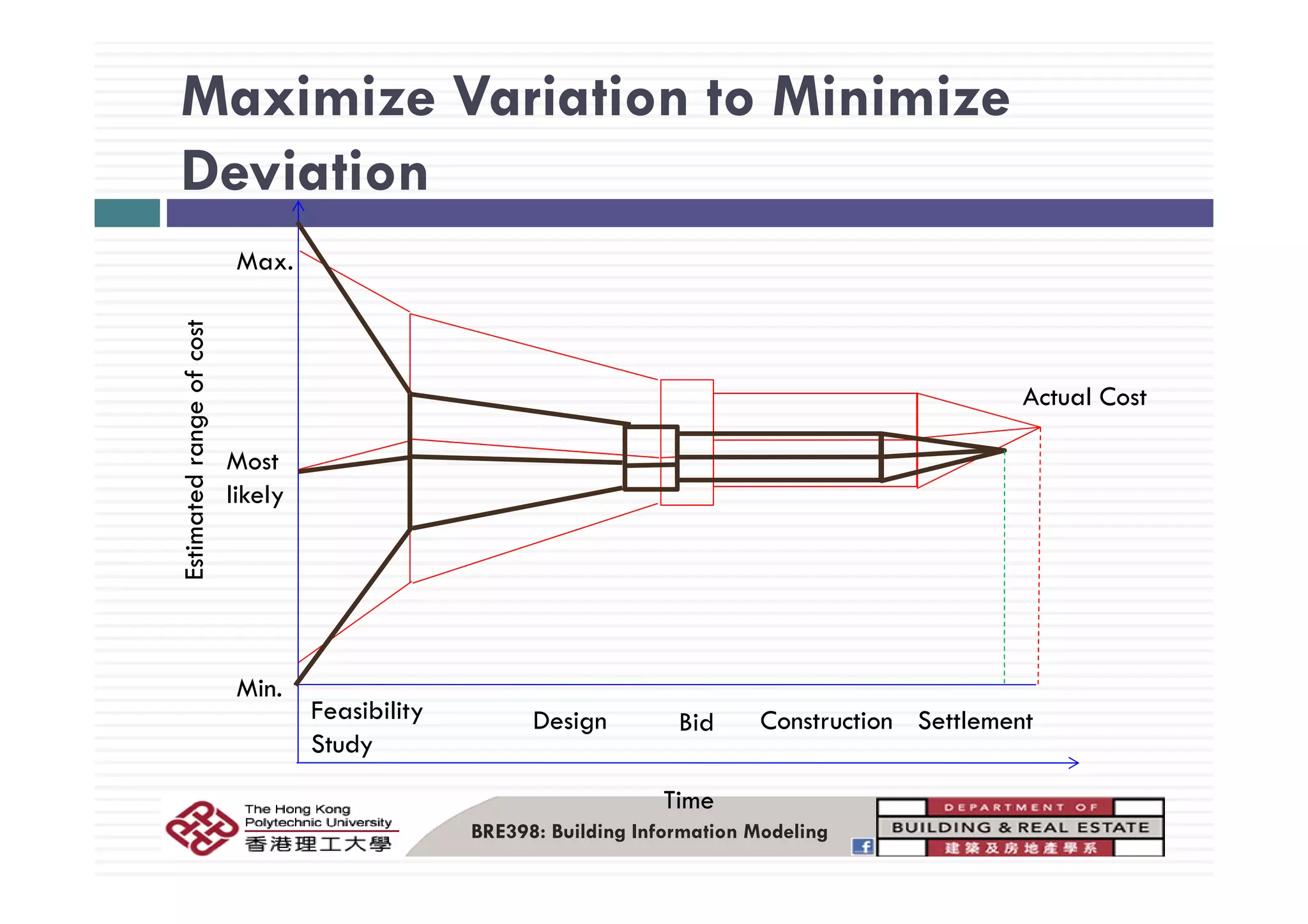

Maximize Variation to Minimize
Deviation
M
cost
Max.
rangeofc
Actual Cost
Most
stimatedr
Most
likely
Es
Feasibility
Study
Design Bid Construction Settlement
Min.
BRE398: Building Information Modeling
Time
3D Visualization
MIT.aviMIT.avi
BRE398: Building Information Modeling

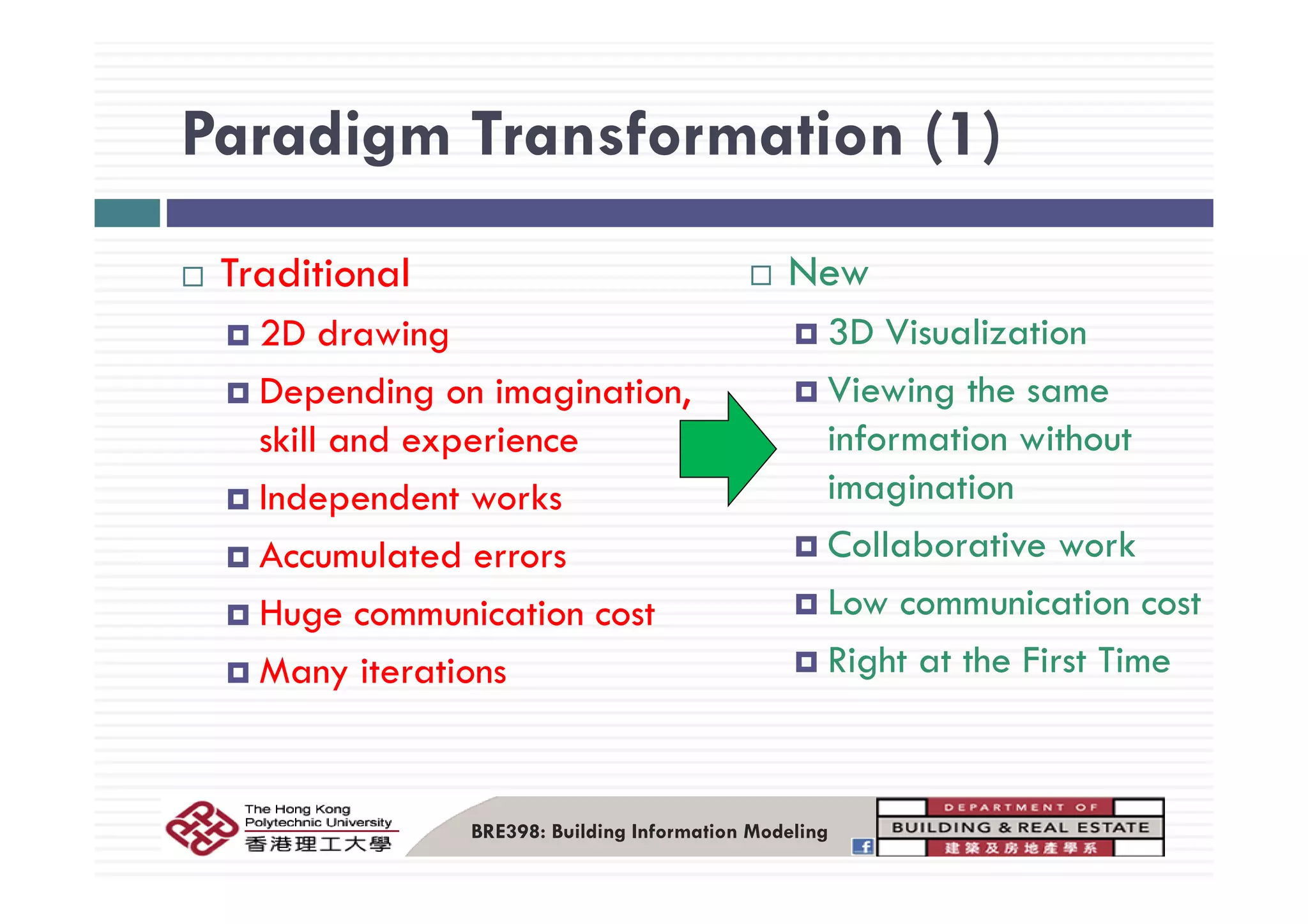

Paradigm Transformation (1)Paradigm Transformation (1)
Traditional
2D drawing
New
3D Visualization
Depending on imagination,
skill and experience
Viewing the same
information without
Independent works
Accumulated errors
imagination
Collaborative workAccumulated errors
Huge communication cost
Many iterations
Low communication cost
Right at the First TimeMany iterations Right at the First Time
BRE398: Building Information Modeling
Challenges of Design ChangesChallenges of Design Changes

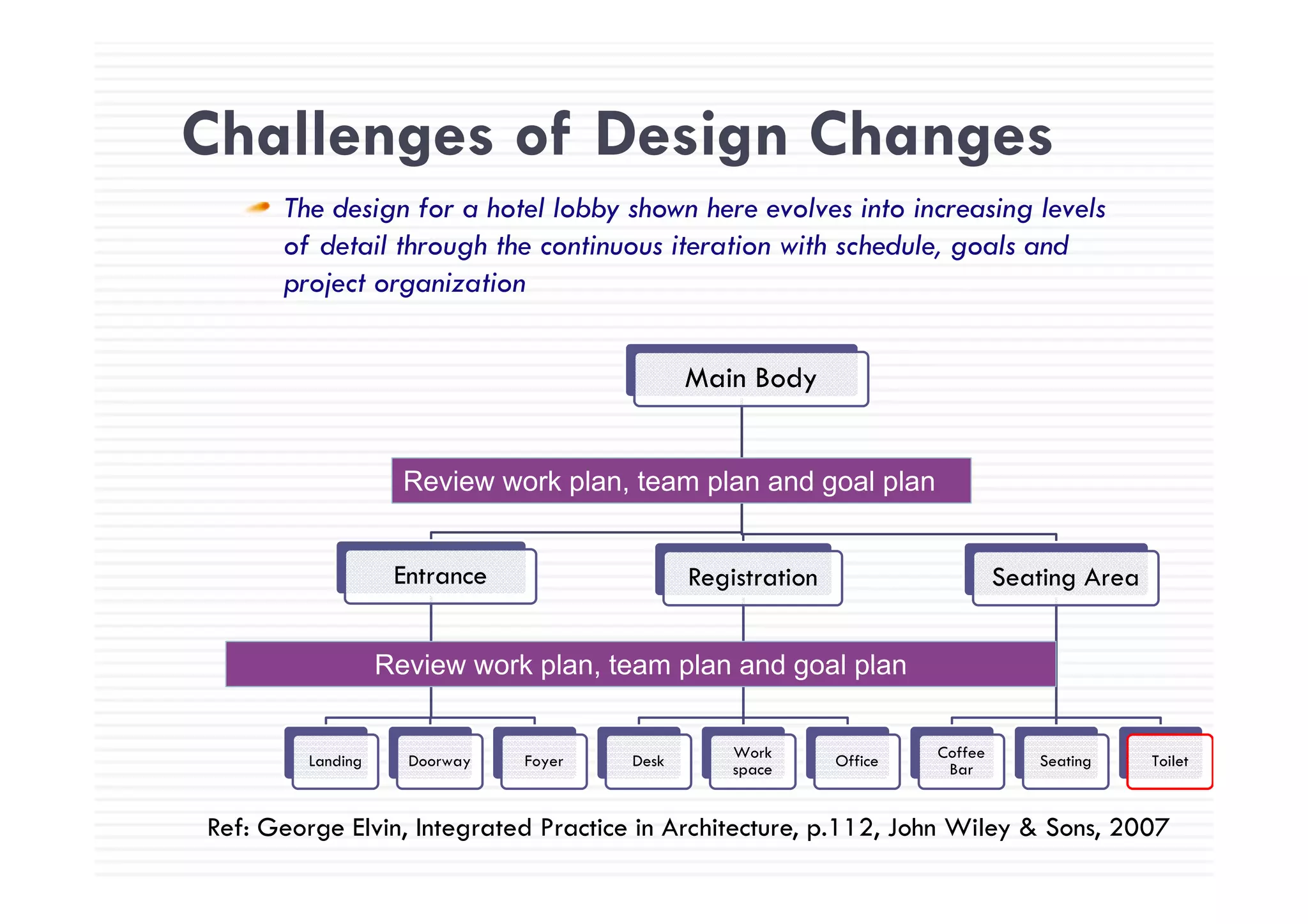

The design for a hotel lobby shown here evolves into increasing levels
of detail through the continuous iteration with schedule, goals andof detail through the continuous iteration with schedule, goals and
project organization
Main Body
E
Review work plan, team plan and goal plan
Entrance Registration Seating Area
Review work plan, team plan and goal plan
Landing Doorway Foyer Desk Work
space Office Coffee
Bar Seating Toilet
Review work plan, team plan and goal plan
p
Ref: George Elvin, Integrated Practice in Architecture, p.112, John Wiley & Sons, 2007

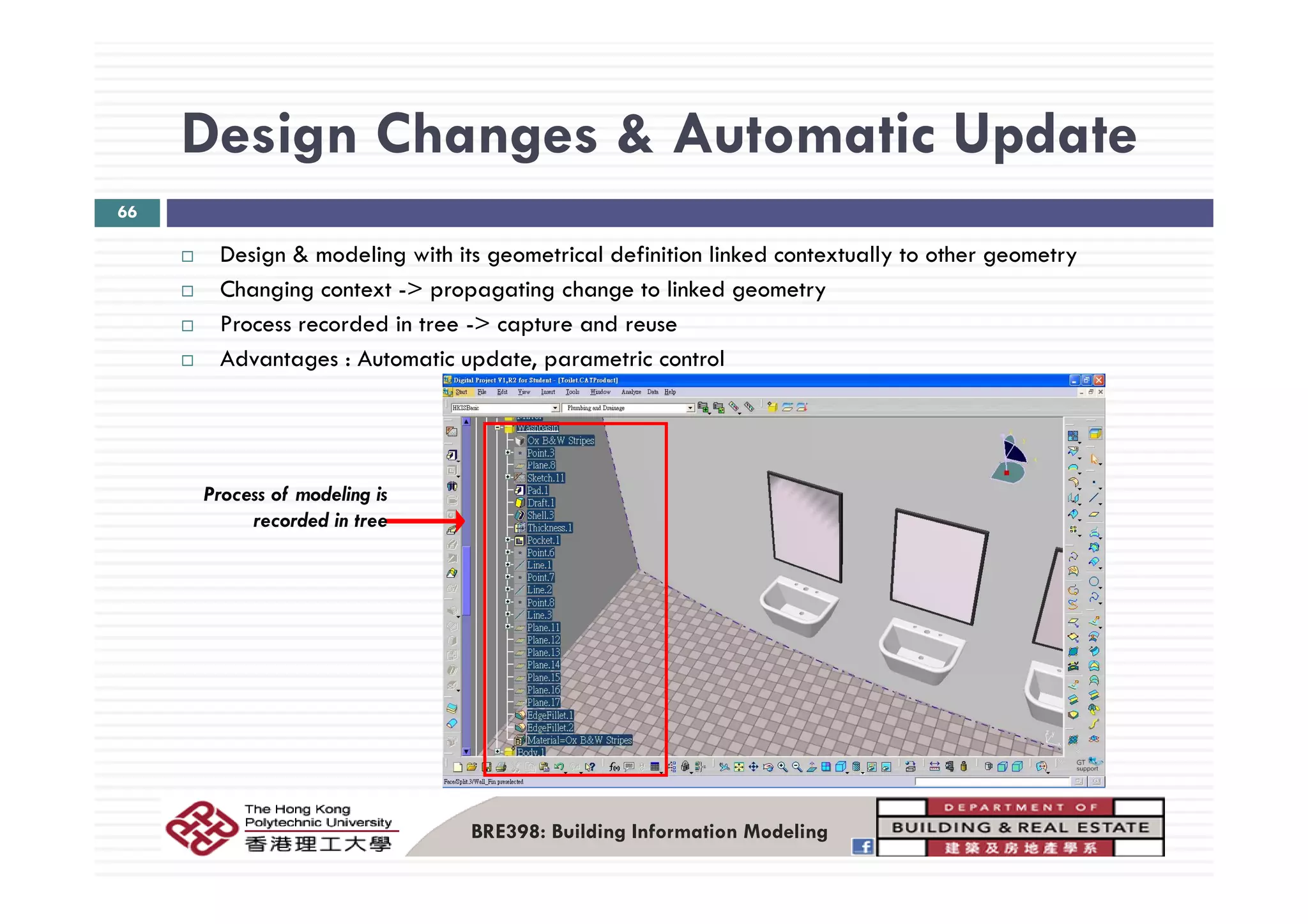

Design Changes & Automatic UpdateDesign Changes & Automatic Update
66
Design & modeling with its geometrical definition linked contextually to other geometryDesign & modeling with its geometrical definition linked contextually to other geometry
Changing context -> propagating change to linked geometry
Process recorded in tree -> capture and reuse
Advantages Automatic update parametric controlAdvantages : Automatic update, parametric control
Process of modeling is
recorded in tree
BRE398: Building Information Modeling

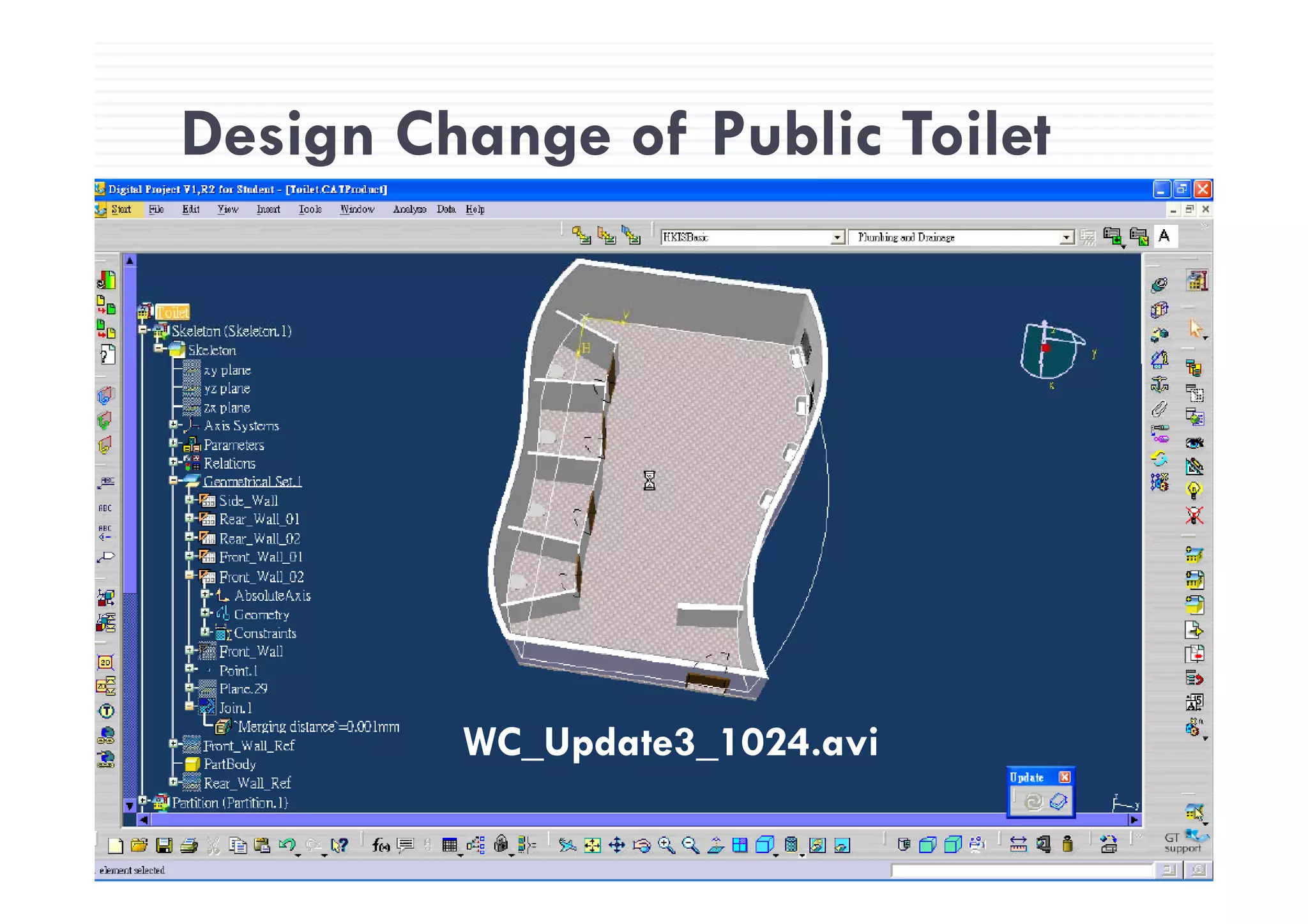

Design Change of Public Toilet
67
Design Change of Public Toilet
WC_Update3_1024.avi
Design Change of Str ct ral Core
68
Design Change of Structural Core
Corewall-Auto Update2 aviCorewall-Auto Update2.avi
69

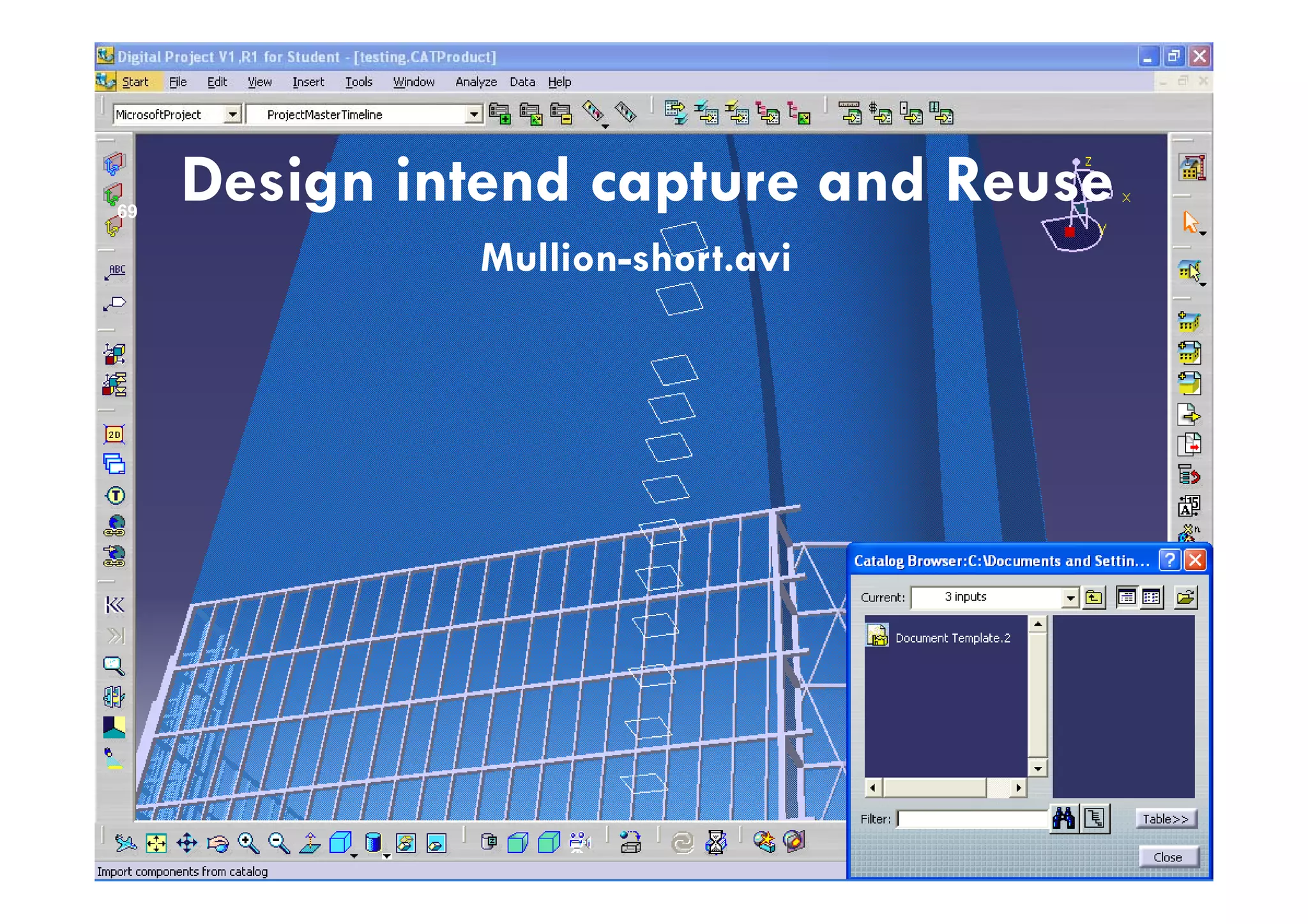

Design intend capture and Reuse
M llion sho t a iMullion-short.avi

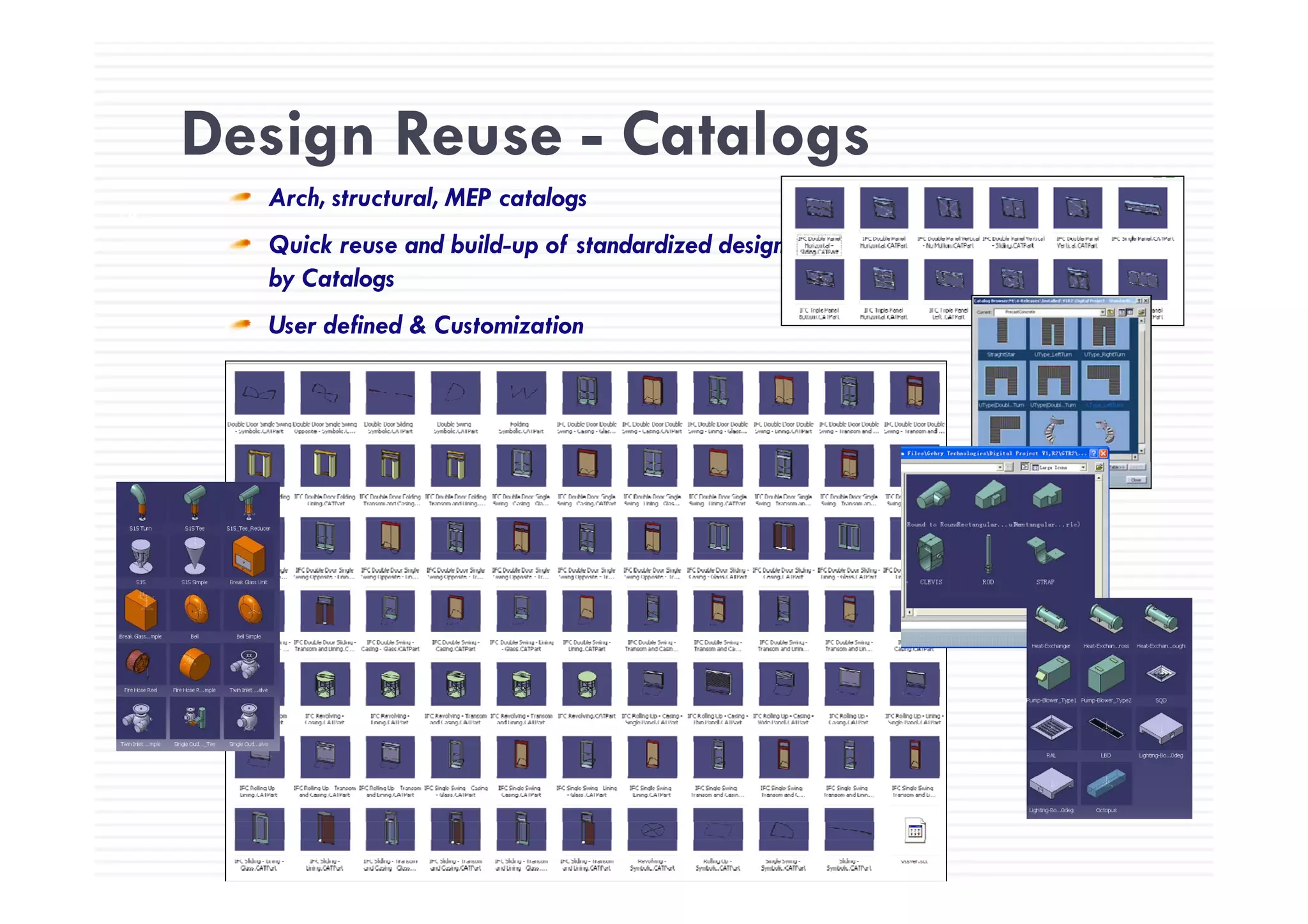

Design Reuse - Catalogs
70
Design Reuse Catalogs
Arch, structural, MEP catalogs
Quick reuse and build-up of standardized designQuick reuse and build up of standardized design
by Catalogs
User defined & Customization
Reuse of Sanitary Fitments and
71
Design Update
Toilet_Auto Update_1280.avi

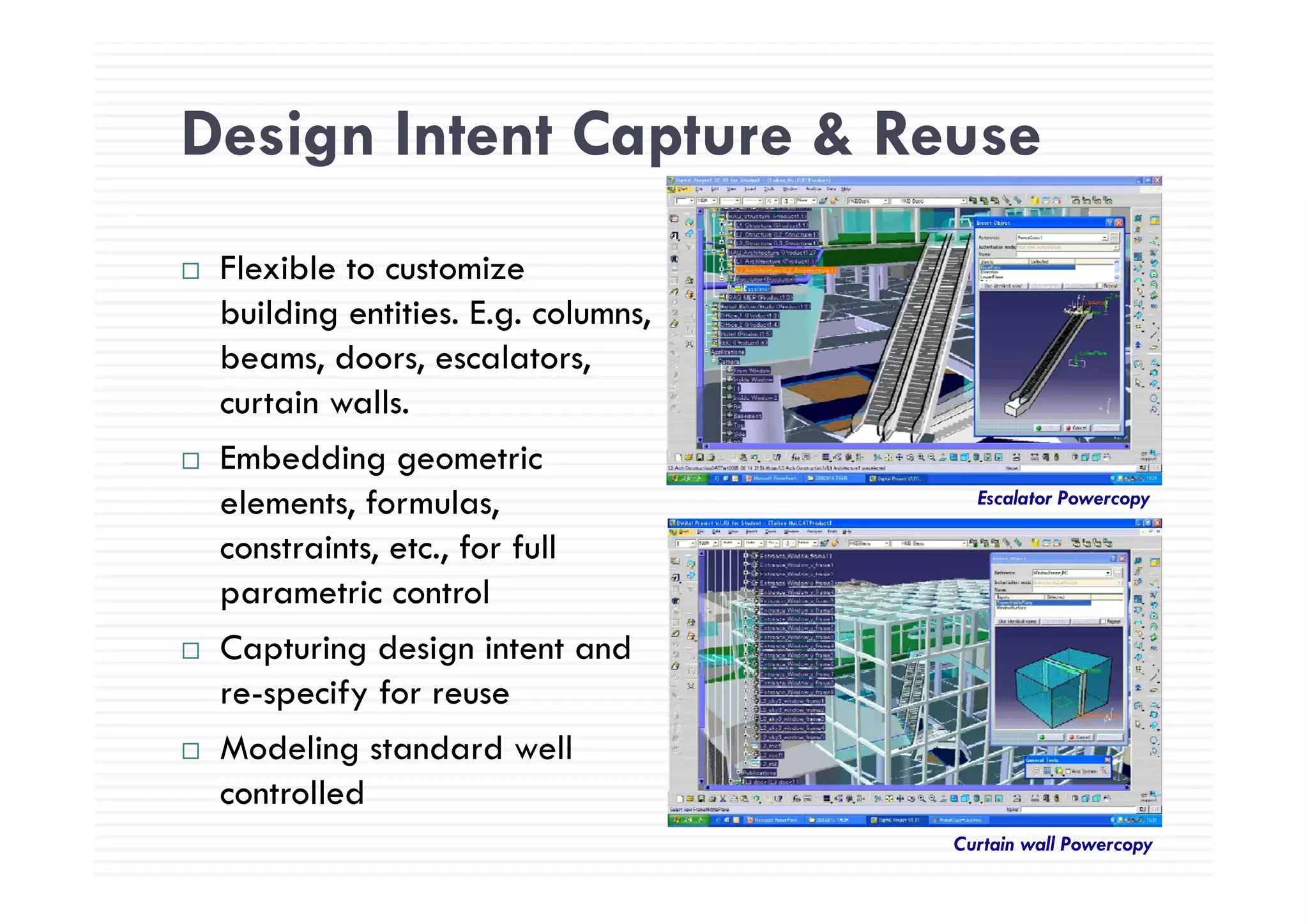

Design Intent Capture & Reuse
72
Design Intent Capture & Reuse
Flexible to customize
building entities. E.g. columns,
beams doors escalatorsbeams, doors, escalators,
curtain walls.
Embedding geometricEmbedding geometric
elements, formulas,
constraints, etc., for full
Escalator Powercopy
parametric control
Capturing design intent and
re-specify for reuse
Modeling standard well
controlled
Curtain wall Powercopy
73

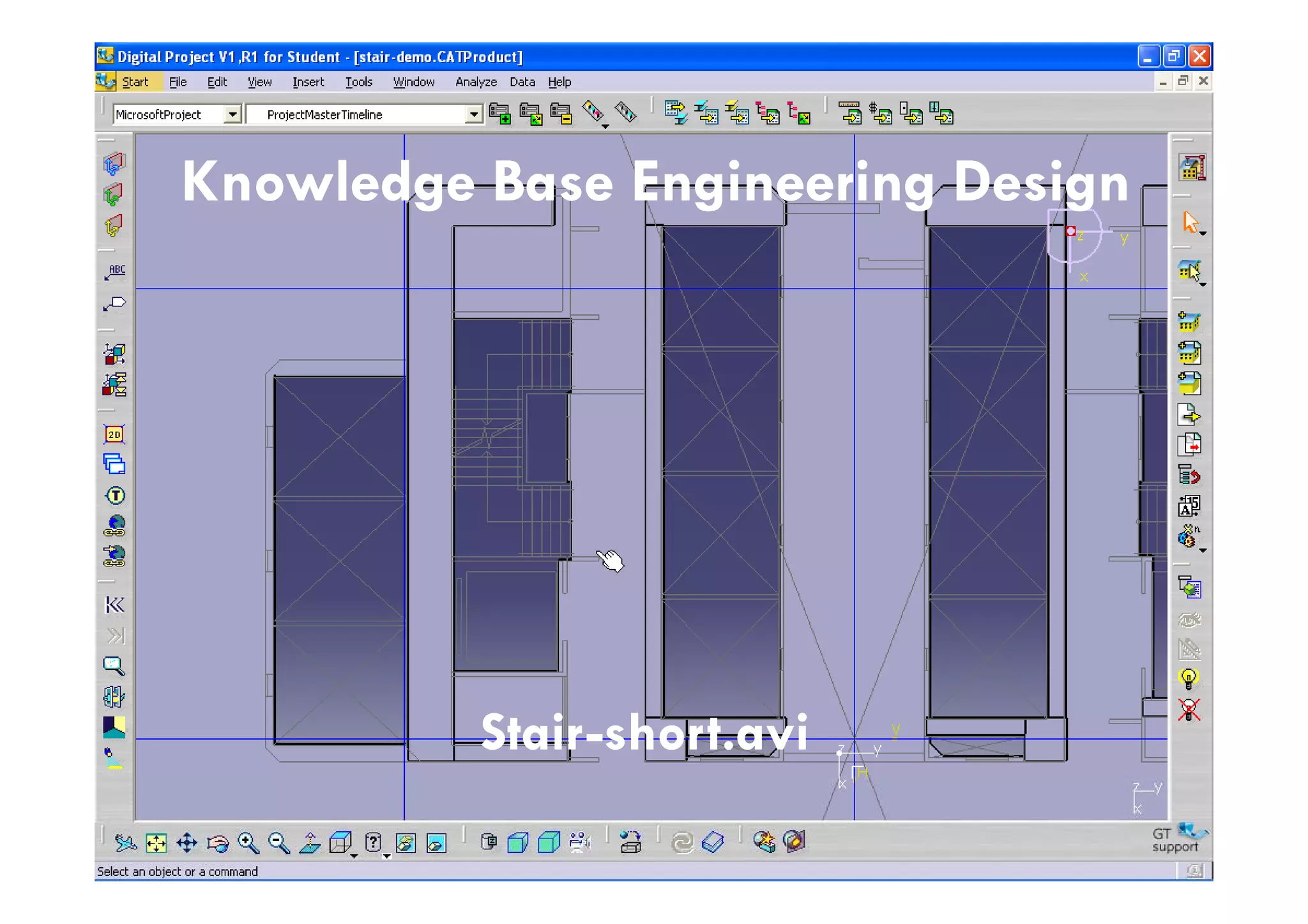

Knowledge Base Engineering DesignKnowledge Base Engineering Design
StairStair--short.avishort.avi

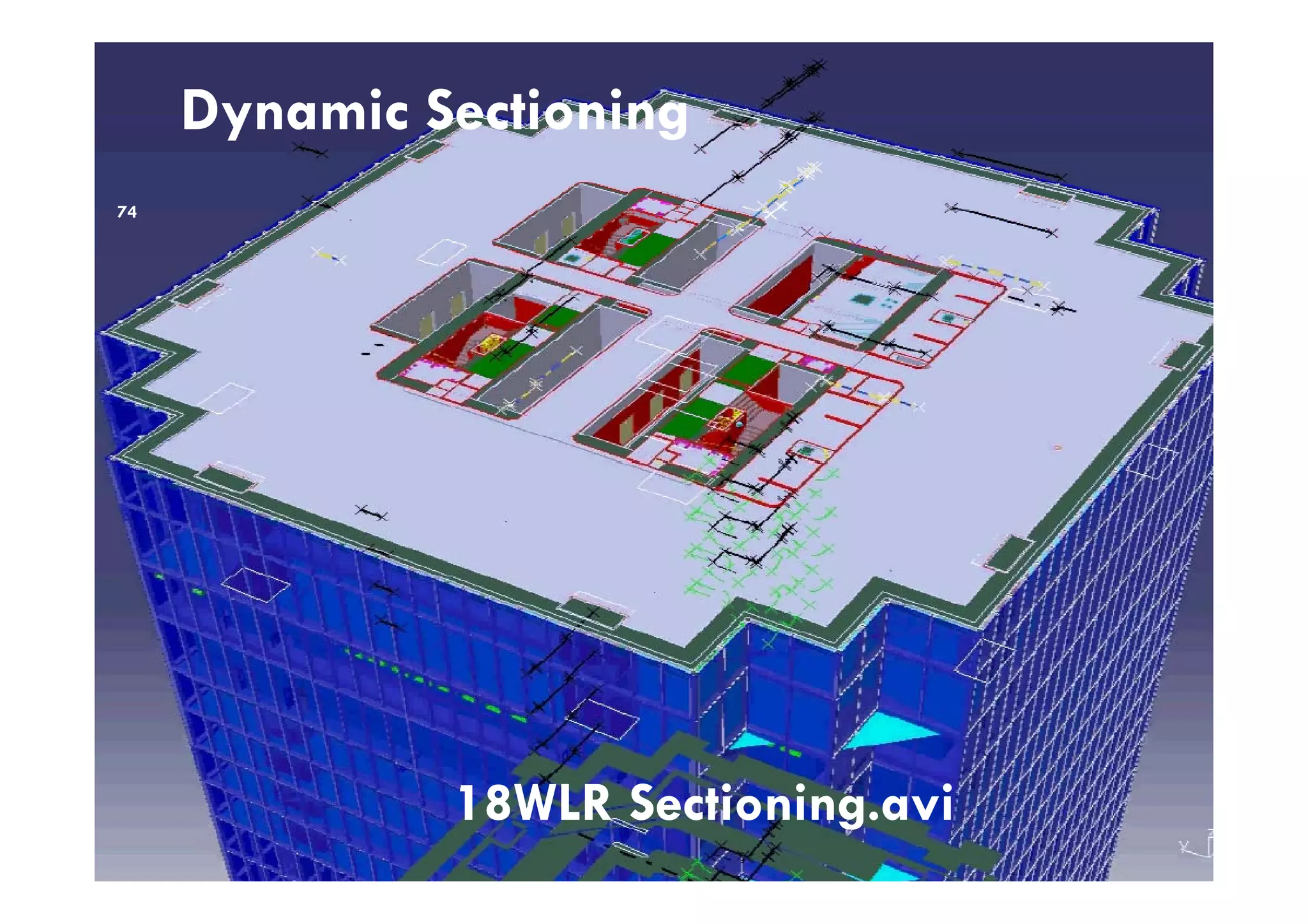

Dynamic SectioningDynamic Sectioning
74
18WLR Sectioning.avi
Drawing ProductionDrawing Production
2D Dressup & Symbols2D Dressup & Symbols
BRE398: Building Information Modeling

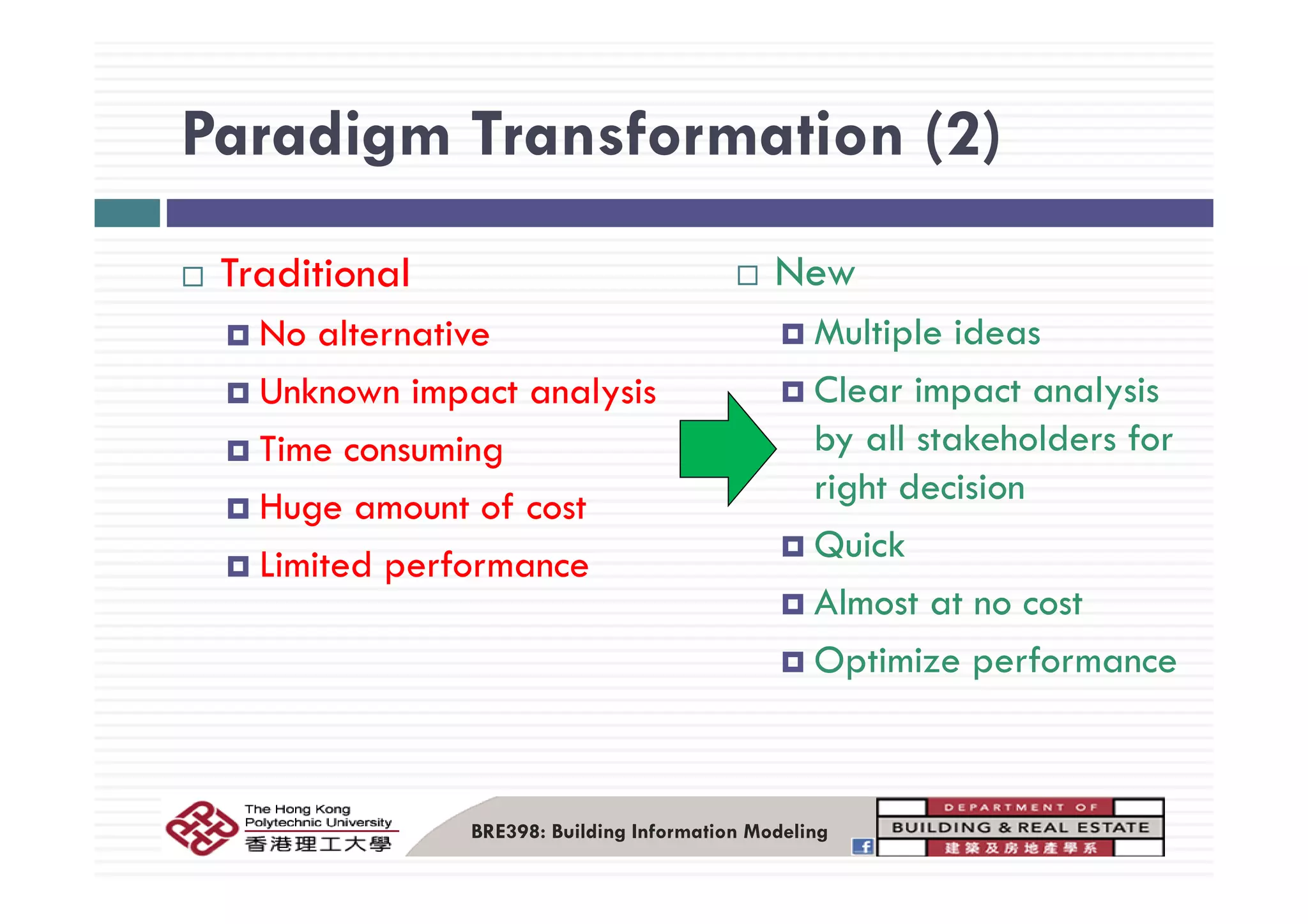

Paradigm Transformation (2)Paradigm Transformation (2)
Traditional
No alternative
New
Multiple ideas
Unknown impact analysis
Time consuming
Clear impact analysis
by all stakeholders forg
Huge amount of cost
Limited performance
right decision
QuickLimited performance
Almost at no cost
Optimize performanceOptimize performance
BRE398: Building Information Modeling
3D Realistic Simulation
Structural Analysis
Di i l M kDigital Mockup
Photo Realistic Rendering
BRE398: Building Information Modelling
Structural Analysis – Data
Interoperability78
St li C ll b tiStreamlines Collaboration
between Architects and
Engineersg
Live integration with Market
leading Structural Analysis tools
R b tRobot
ETABS
SAP2000
IFC
Export
Interoperate between IGES, STEP,
3D Dxf and Dwg (Autocad),
SDNFSDNF
CIS/2 (design data) export
BRE398: Building Information Modeling
Structural Analysis – Data Integration
79
Structural Analysis Data Integration
Drawings
Specification
Bidding
Des
autocad®
3D Master
E i i
Bidding
sign&Co
Model
Engineering
onstruction
STEP
CIS/2
Fluent
Fabrication
nProcess
Fluent
…
Construction
Structural Analysis in Civil
Engineering
Rendering & VisualizationRendering & Visualization
BRE398: Building Information Modeling
MTECH Confidential– 2005 Page 81
Rendering & VisualizationRendering & Visualization
BRE398: Building Information Modeling
MTECH Confidential– 2005 Page 82
Rendering & VisualizationRendering & Visualization
BRE398: Building Information Modeling
MTECH Confidential– 2005 Page 83
Rendering & VisualizationRendering & Visualization
BRE398: Building Information Modeling
MTECH Confidential– 2005 Page 84

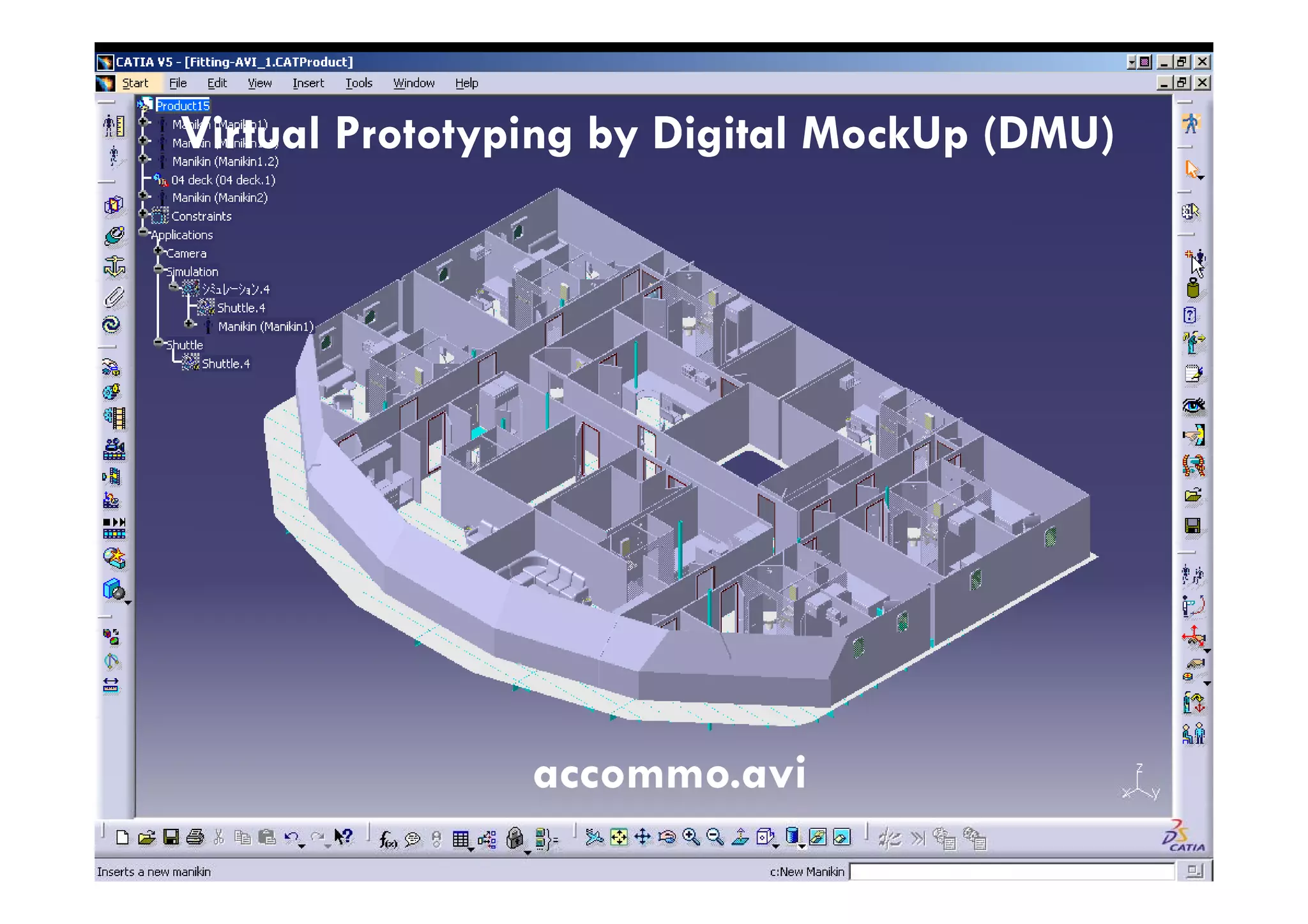

Virtual Prototyping by Digital
MockUp (DMU)85
Typical AEC projects are 2D basedTypical AEC projects are 2D based
2D does not represent the reality and is subject to mis-
understandingunderstanding
Owner facing
•Critical decision
information
•Marketing
BRE398: Building Information Modeling
Virtual Prototyping by DigitalVirtual Prototyping by Digital MockUpMockUp (DMU)(DMU)Virtual Prototyping by DigitalVirtual Prototyping by Digital MockUpMockUp (DMU)(DMU)
accommo aviaccommo aviaccommo.aviaccommo.avi
Design for Operations and
Maintenance87

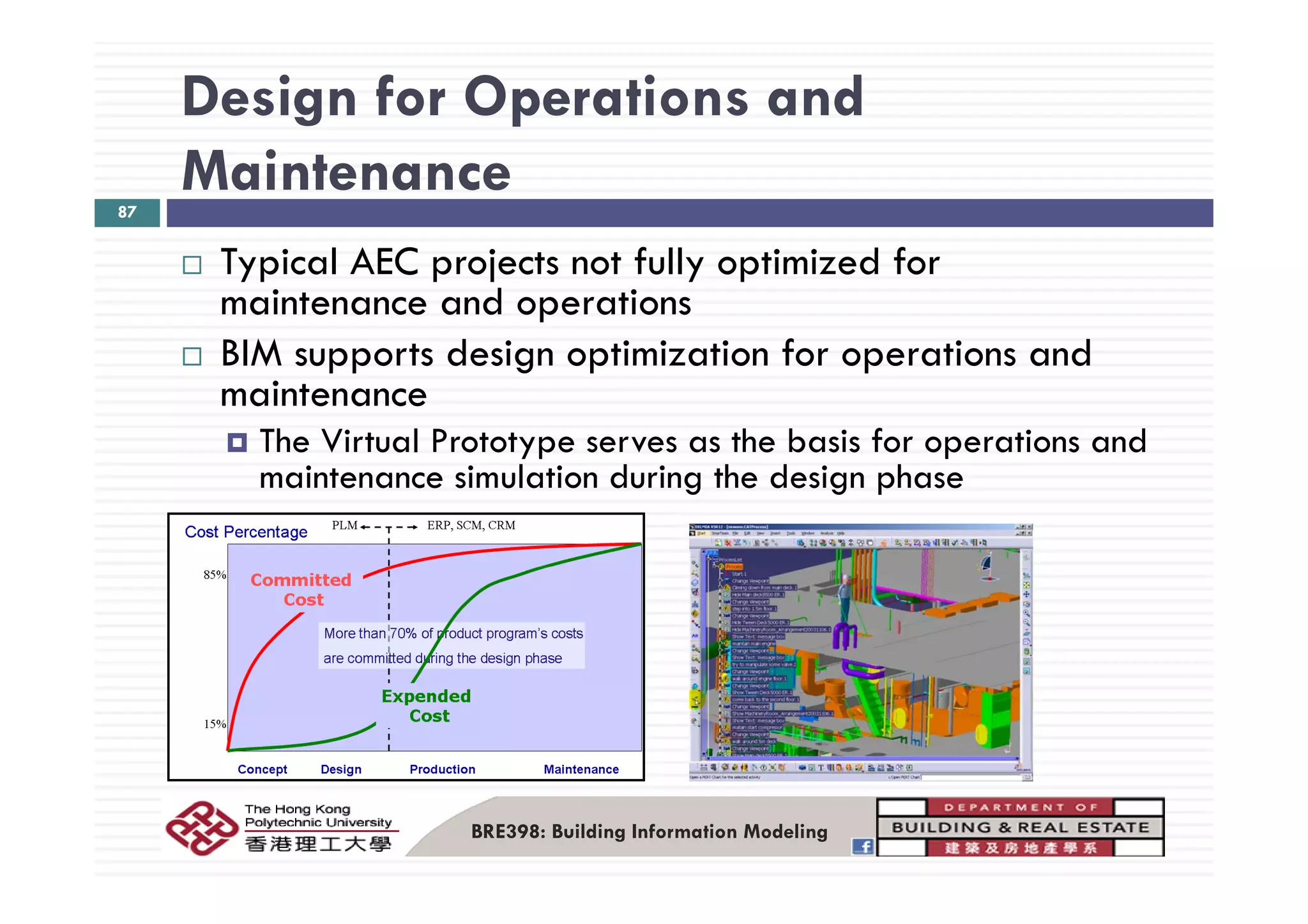

T i l AEC j t t f ll ti i d fTypical AEC projects not fully optimized for
maintenance and operations
BIM supports design optimization for operations andBIM supports design optimization for operations and
maintenance
The Virtual Prototype serves as the basis for operations and
maintenance simulation during the design phase
BRE398: Building Information Modeling
Design for Operations and MaintenanceDesign for Operations and Maintenance
mainte.avimainte.avi
BRE398: Building Information Modeling
Values of BIMValues of BIM
According to Middlebrooks (2008), BIM promotes
facility management. Facility personnel use BIM to
access data stored in a single repository to prepare
schedules, implement daily operations and make
predictive and futuristic plans with regard to
purchases and construction activities.
BRE398: Building Information Modeling
Lighting Realization, Analysis &
Measurement
Analyze and virtually validate innovative
lighting systems
Ph t t i l i t i i t lPhotometric, colorimetric virtual
measurement and analysis
Taking into account real measured opticalTaking into account real measured optical
properties of materials, surfaces
Y h 01 / 02
BRE398: Building Information Modeling
Yacht01 / 02. wmv

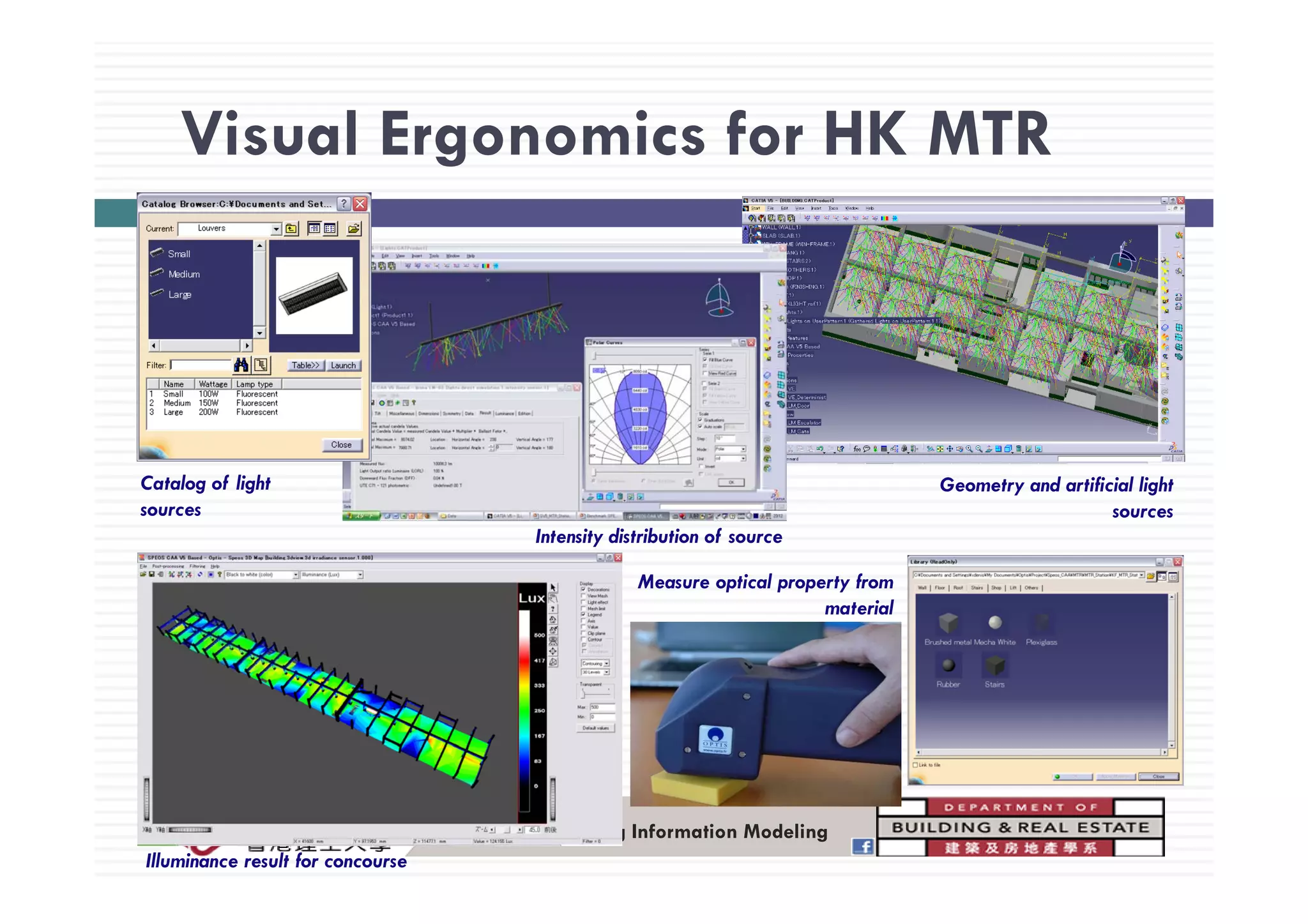

Visual Ergonomics for HK MTRVisual Ergonomics for HK MTR
Geometry and artificial light
sources
Catalog of light
sources
Intensity distribution of source
Measure optical property from
material
BRE398: Building Information Modeling
Illuminance result for concourse
Visual Ergonomics for HK MTRVisual Ergonomics for HK MTR
BRE398: Building Information Modeling
Luminance Analysis
HVAC Engineering Fluid Dynamic

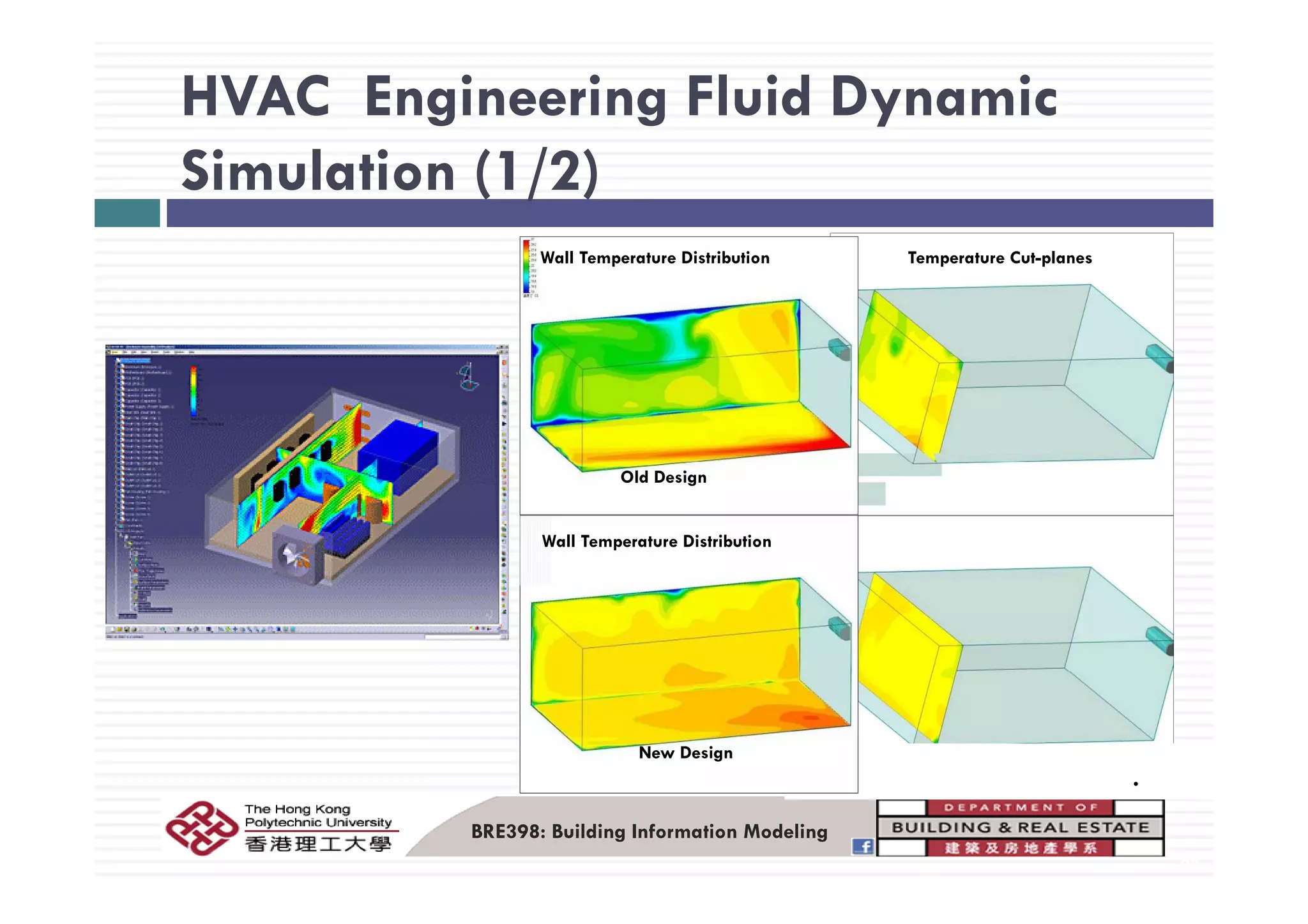

/Simulation (1/2)
W ll T Di ib i T C lWall Temperature Distribution Temperature Cut-planes
Old Design
Wall Temperature Distribution
New Design
BRE398: Building Information Modeling
93
.
HVAC Engineering Fluid Dynamic

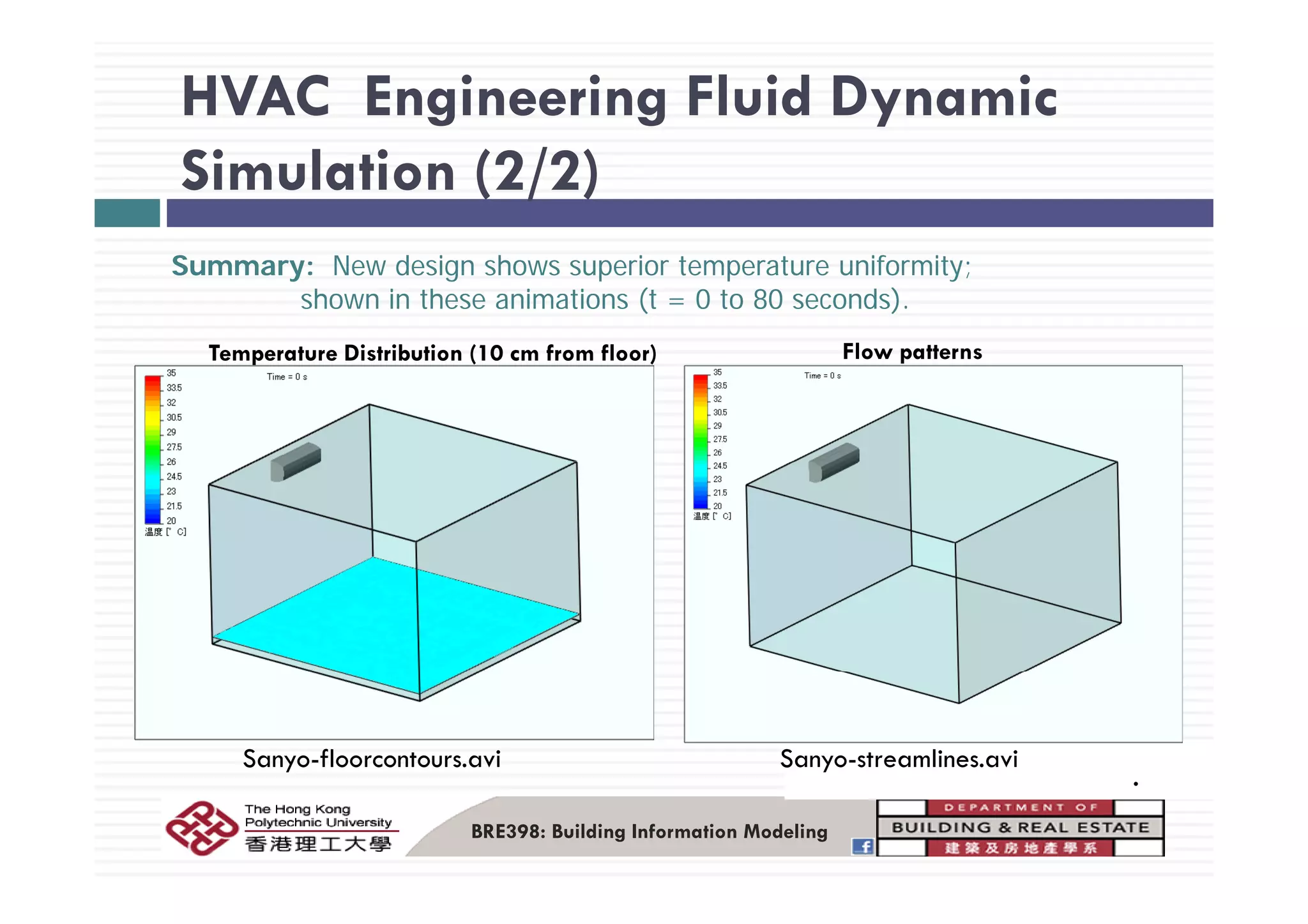

/Simulation (2/2)
Temperature Distribution (10 cm from floor) Flow patterns
Summary: New design shows superior temperature uniformity;
shown in these animations (t = 0 to 80 seconds).
Temperature Distribution (10 cm from floor) Flow patterns
Sanyo-floorcontours.avi Sanyo-streamlines.avi
BRE398: Building Information Modeling
.

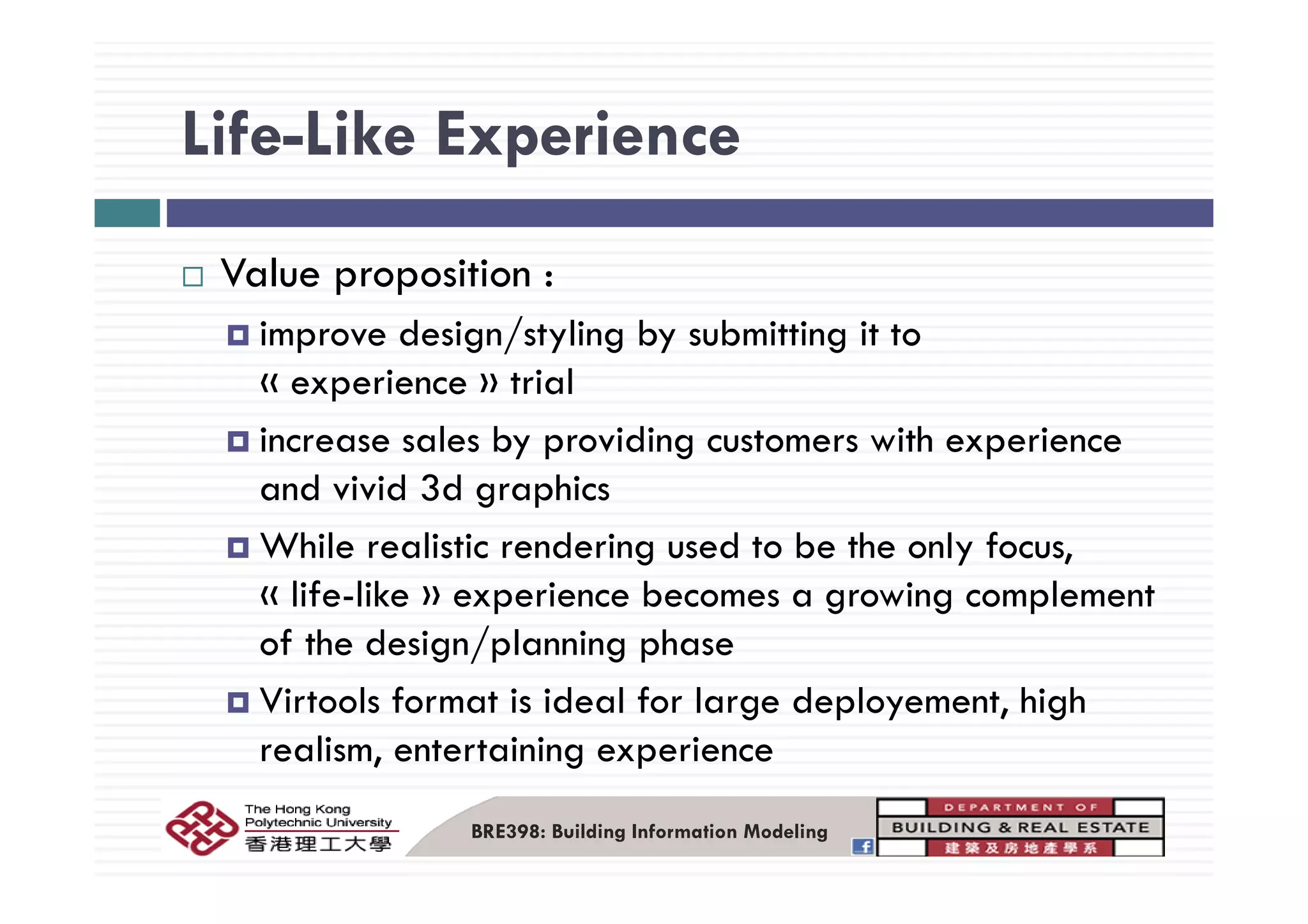

Life-Like ExperienceLife Like Experience
Value proposition :
improve design/styling by submitting it to
« experience » trial
increase sales by providing customers with experience
and vivid 3d graphics
While realistic rendering used to be the only focus,
« life-like » experience becomes a growing complement
of the design/planning phase
Virtools format is ideal for large deployement, high
realism, entertaining experience
BRE398: Building Information Modeling
Application of Life-Like ExperienceApplication of Life Like Experience
City / Urban Planning
Realistic experience / simulation
Interior / Exterior Design
Realistic experience / simulationp /
Large model visualization
Realistic experience / simulation
3D option simulation
Virtual Showroom
Entertaining experience T i i M i t & M it iEntertaining experience
Wide range of deployment
Training, Maintenance & Monitoring
Interactive 3D application
Various input device support

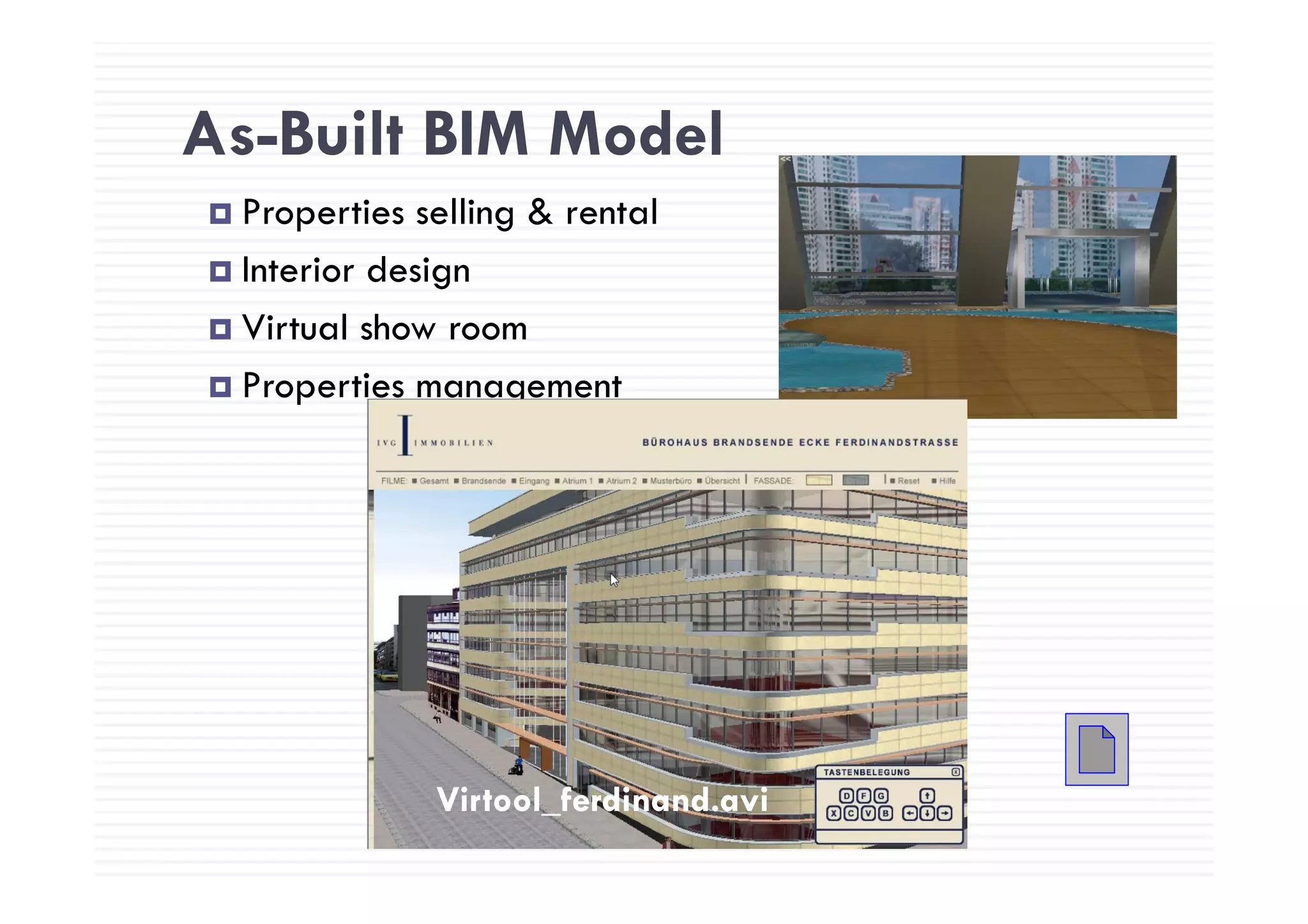

As-Built BIM ModelAs Built BIM Model
Properties selling & rental
Interior design
Virtual show room
Properties management
Virtool_ferdinand.aviVirtool_ferdinand.avi
Shopping Mall ConfiguratorShopping Mall Configurator
BRE398: Building Information Modeling
98

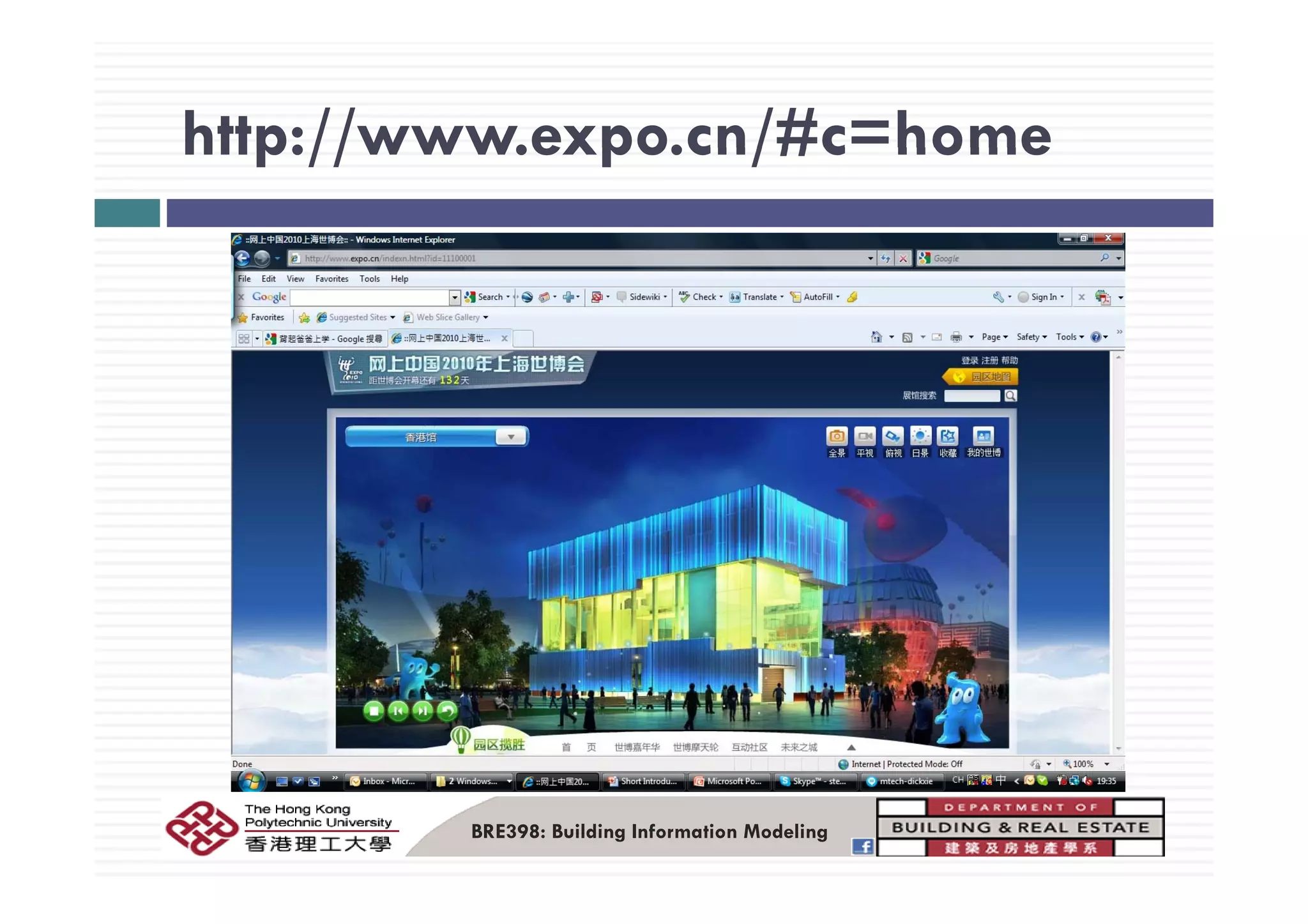

http://www.expo.cn/#c=homehttp://www.expo.cn/#c home
BRE398: Building Information Modeling

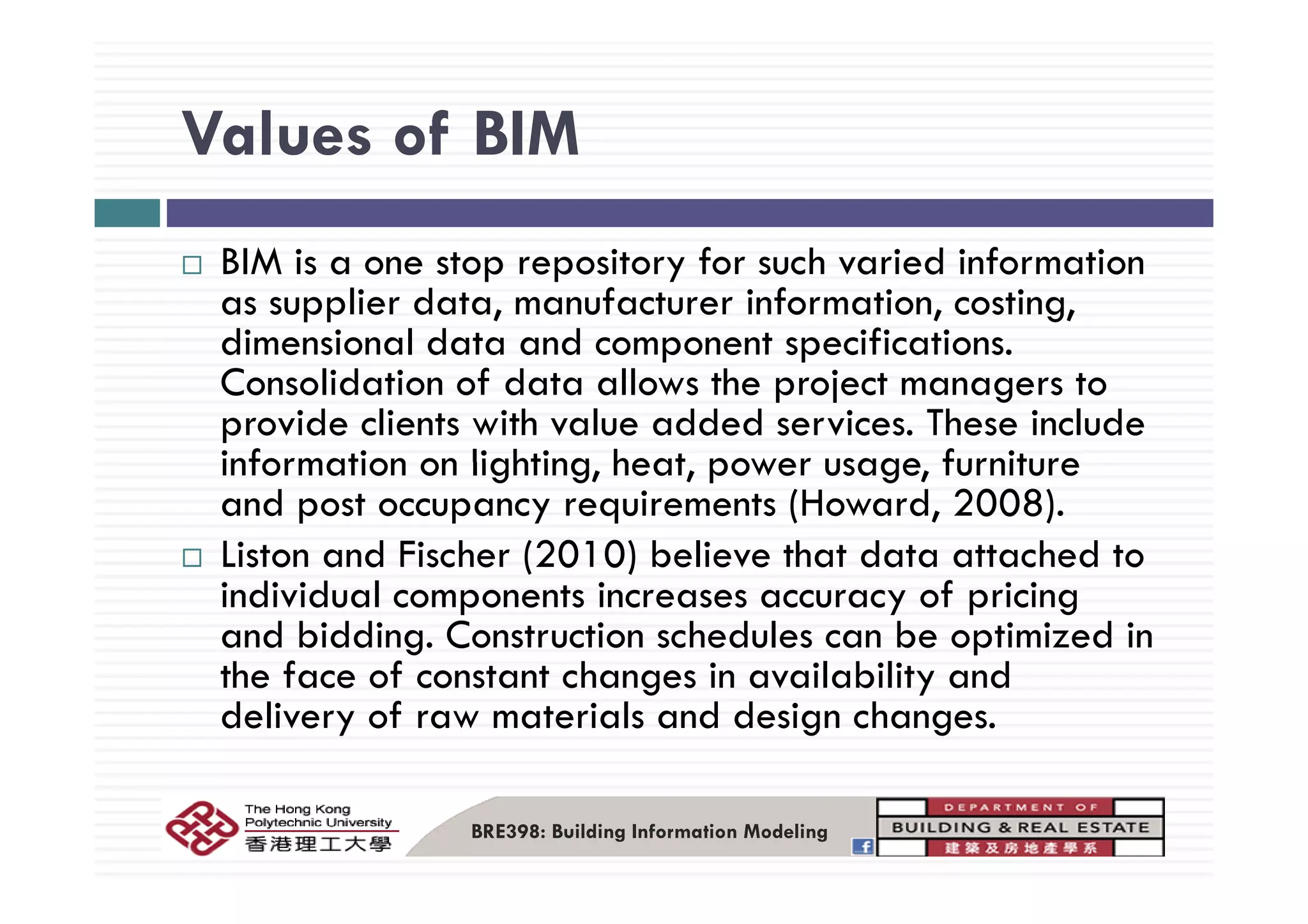

Values of BIMValues of BIM
BIM allows visualization of form with some
resemblance to realities (Manning and Messner,
2008). This allows evaluation of both aesthetic and
functional features. Thus even non – technical
stakeholders can easily understand these models.
BIM reduces safety barriers which in turn reduceBIM reduces safety barriers which in turn reduce
insurance costs, legal fees and professional
liabilities.liabilities.
BRE398: Building Information Modeling
4D BIM = 3D + Schedule (Time)
The construction of the 4D models enables the various participants
(from architects, designers, contractors to owners) of a
construction project, to visualize the entire duration of a series of
events and display the progress of construction activities through
the life time of the project. This BIM-centric approach towardsp j pp
project management technique has a very high potential to
improve the project management and delivery of construction
project, of any size or complexity.project, of any size or complexity.
BRE398: Building Information Modelling

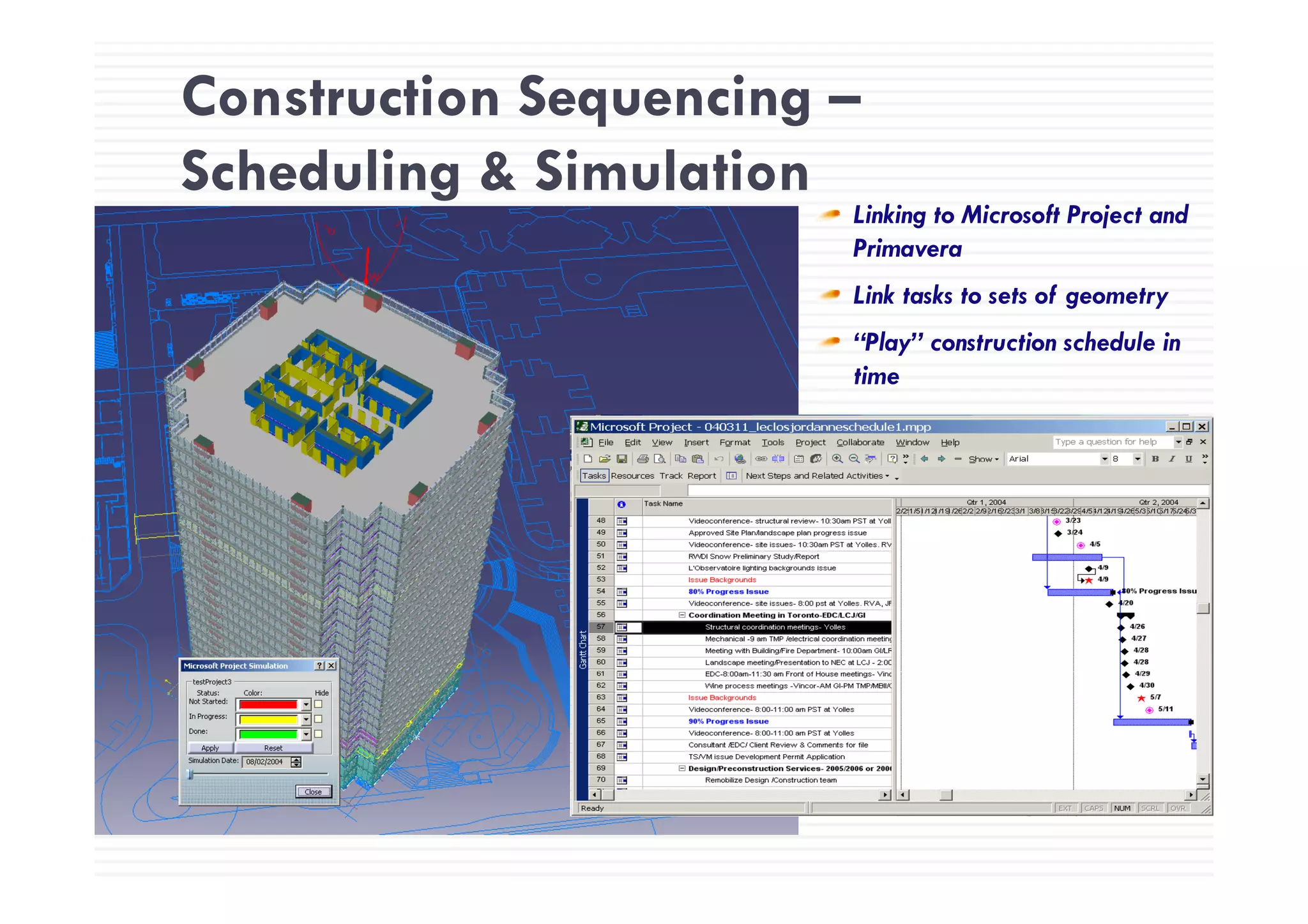

Construction Sequencing –
Scheduling & Simulation
Linking to Microsoft Project and
PrimaveraPrimavera
Link tasks to sets of geometry
“Play” construction schedule in
time
Construction SequencingConstruction Sequencing ––q gq g
Scheduling & SimulationScheduling & Simulation
Construction 1024 x 768.aviConstruction 1024 x 768.avi
BRE398: Building Information Modeling
MTECH Confidential– 2005 Page
Construction 1024 x 768.aviConstruction 1024 x 768.avi
5D BIM = 3D + schedule (time) + cost
which refers to the intelligent linking of individual 3D CAD components or
assemblies with schedule (time) constraint and cost-related information.
Th f h 5D i i d d f h ddi i f f hThe use of the term 5D is intended to refer to the addition of fourth
dimension: time and fifth dimension: cost to the 3D model, i.e. 5D is 3D +
schedule (time) + cost.
The construction of the 5D models enables the various participants ( from
architects, designers, contractors to owners) of any construction project,
to visualize the progress of construction activities and its related costs
Mover time. This BIM-centric project management technique has a potential
to vastly improves the project management and delivery of construction
project of any size and complexity.
BRE398: Building Information Modelling

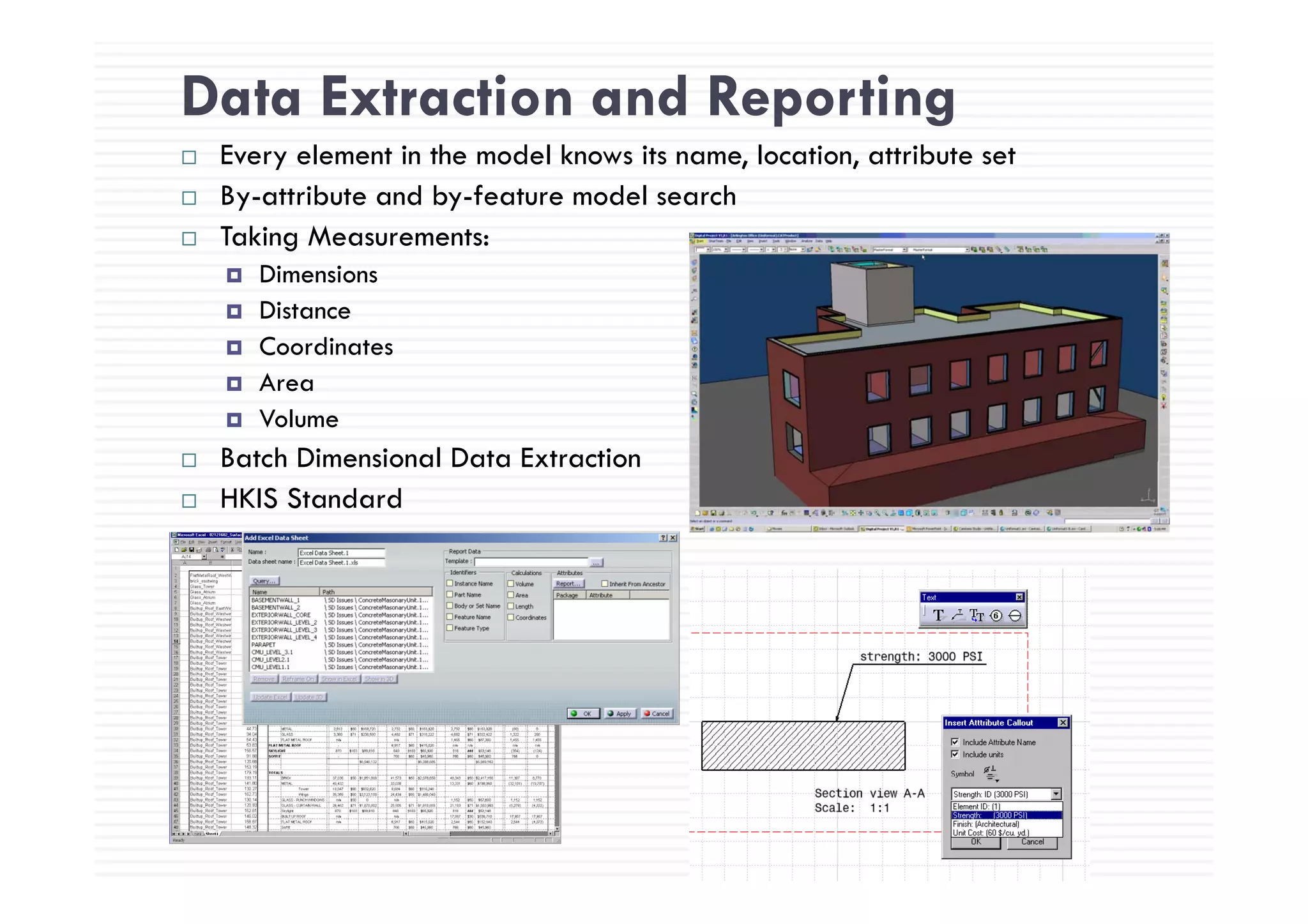

Data Extraction and Reporting
E l i h d l k i l i ibEvery element in the model knows its name, location, attribute set
By-attribute and by-feature model search
Taking Measurements:
Dimensions
Distance
Coordinates
Area
Volume
Batch Dimensional Data ExtractionBatch Dimensional Data Extraction
HKIS Standard
MaterialsMaterials

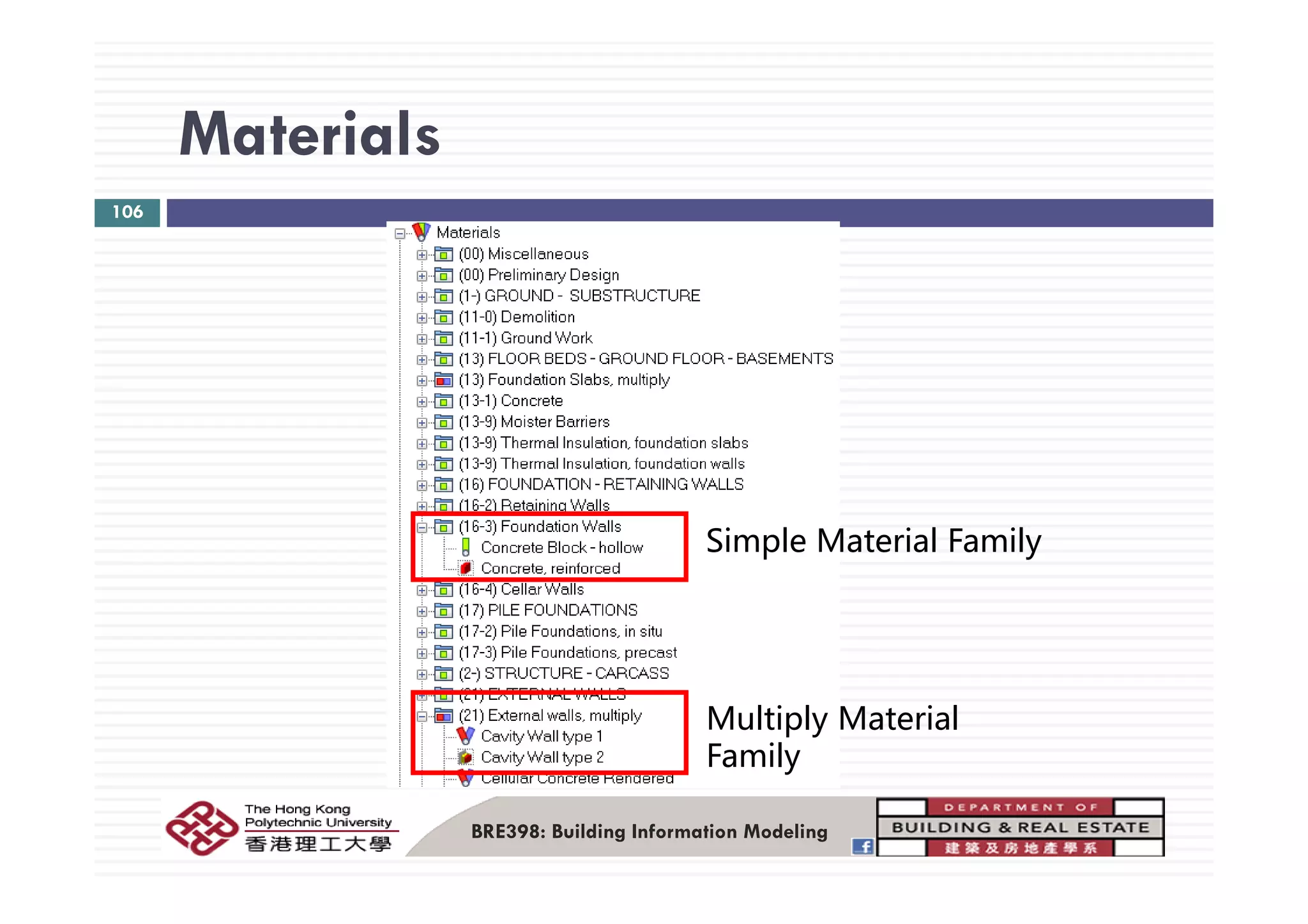

106

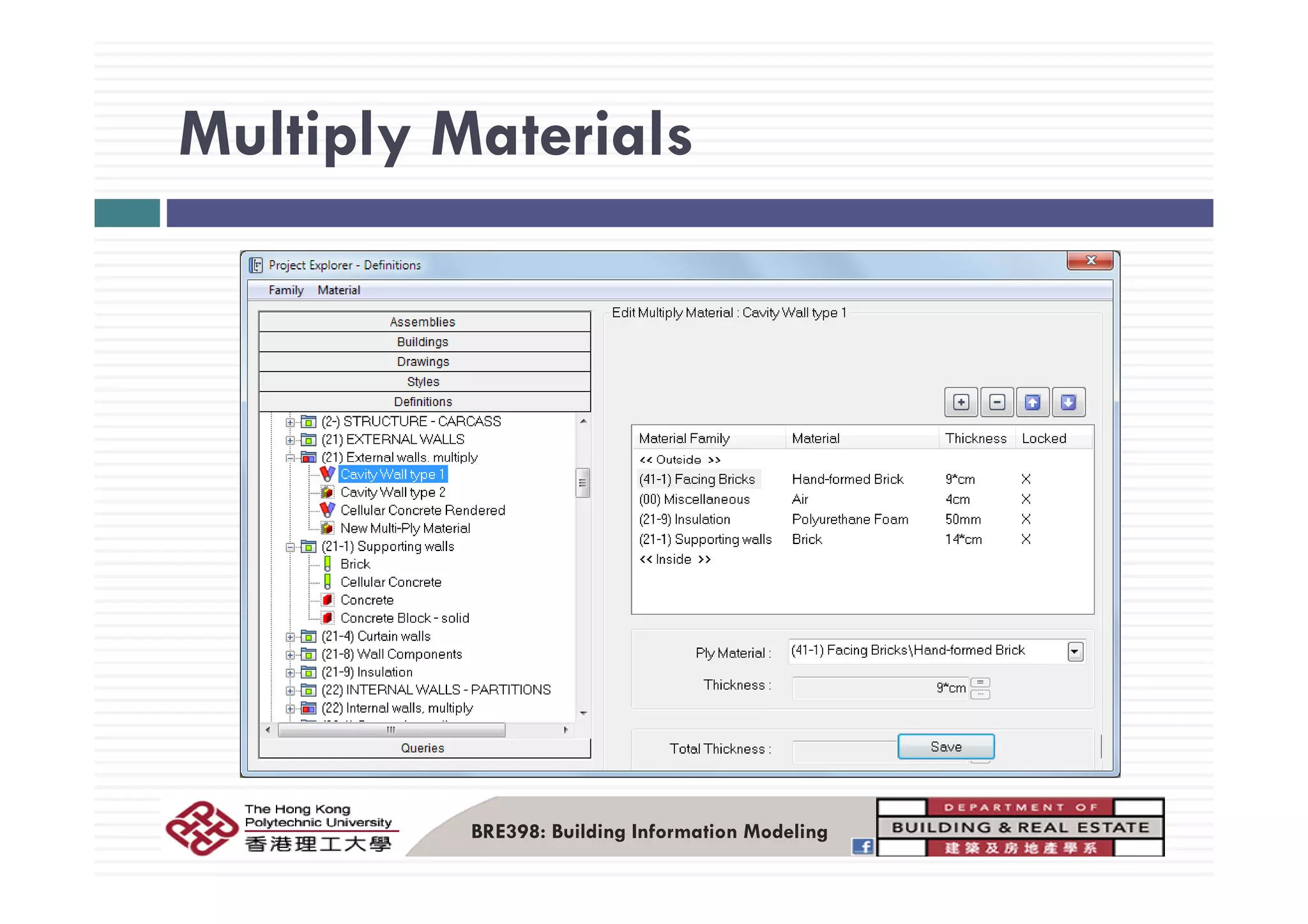

SimpleMaterial Family
Multiply Material
Family
BRE398: Building Information Modeling
Simple MaterialsSimple Materials
BRE398: Building Information Modeling
Multiply MaterialsMultiply Materials
BRE398: Building Information Modeling

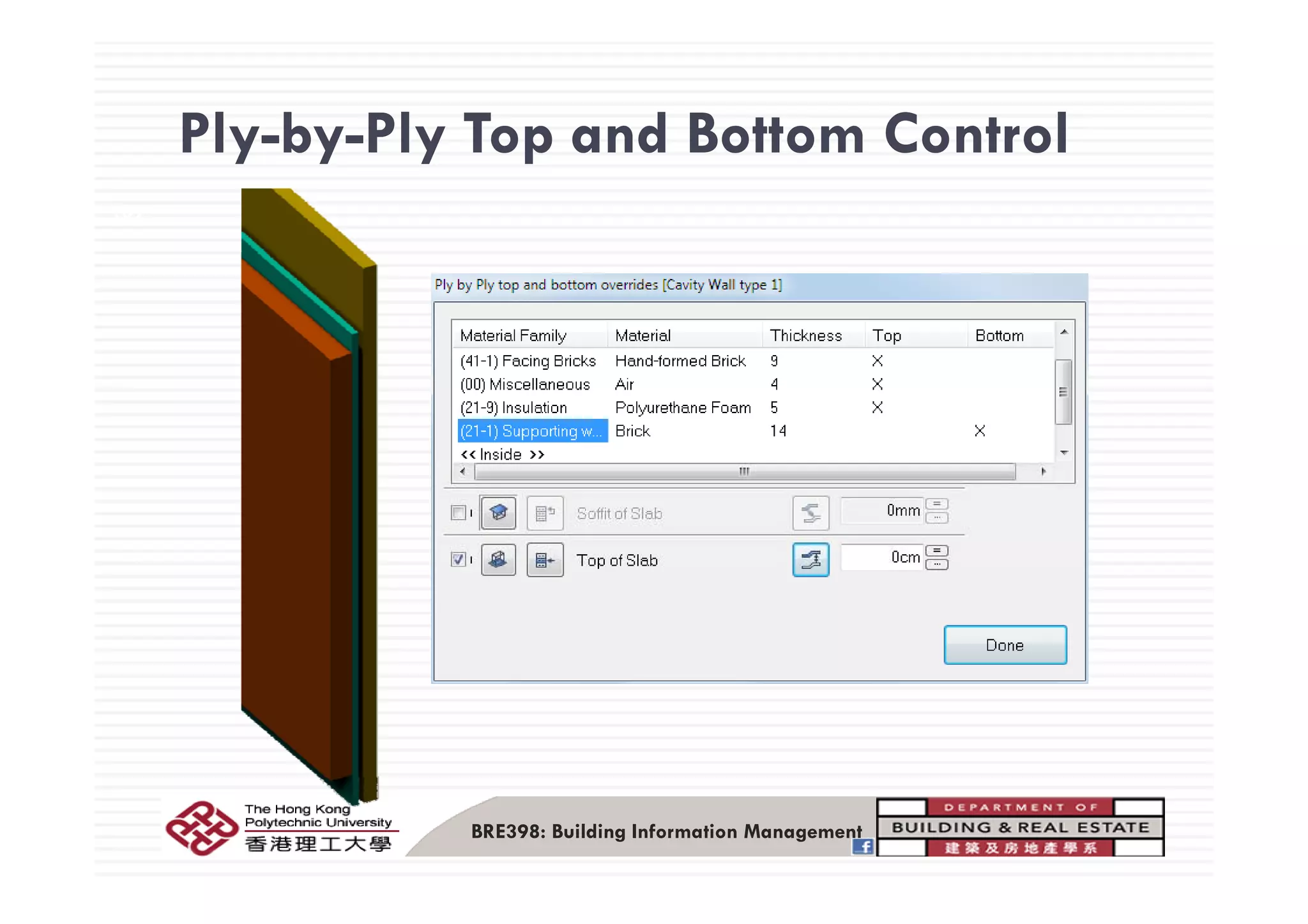

Ply-by-Ply Top and Bottom ControlPly by Ply Top and Bottom Control
109
BRE398: Building Information Management
Cost itemsCost items
BRE398: Building Information Modeling
110

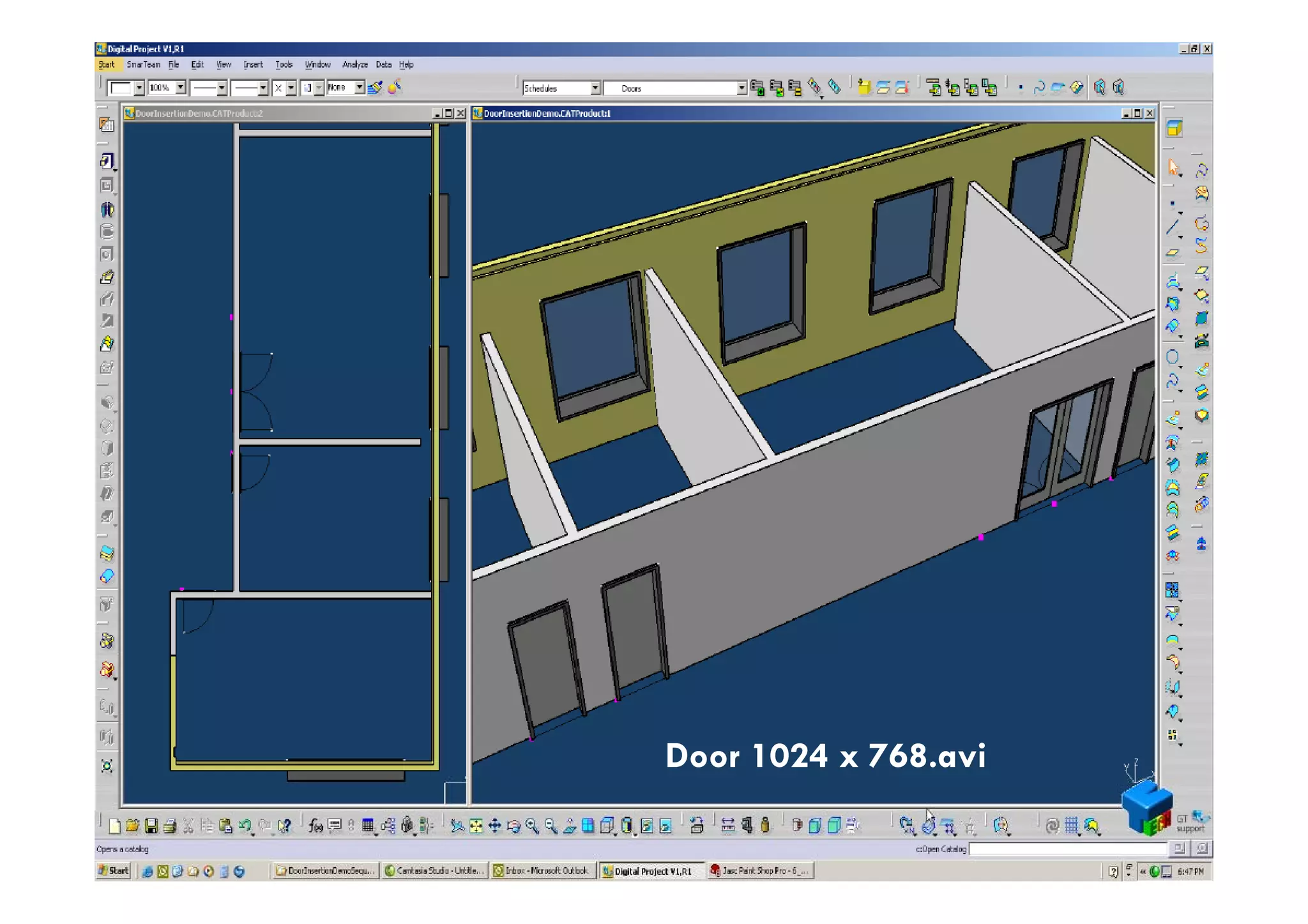

Door 1024 x 768.avi

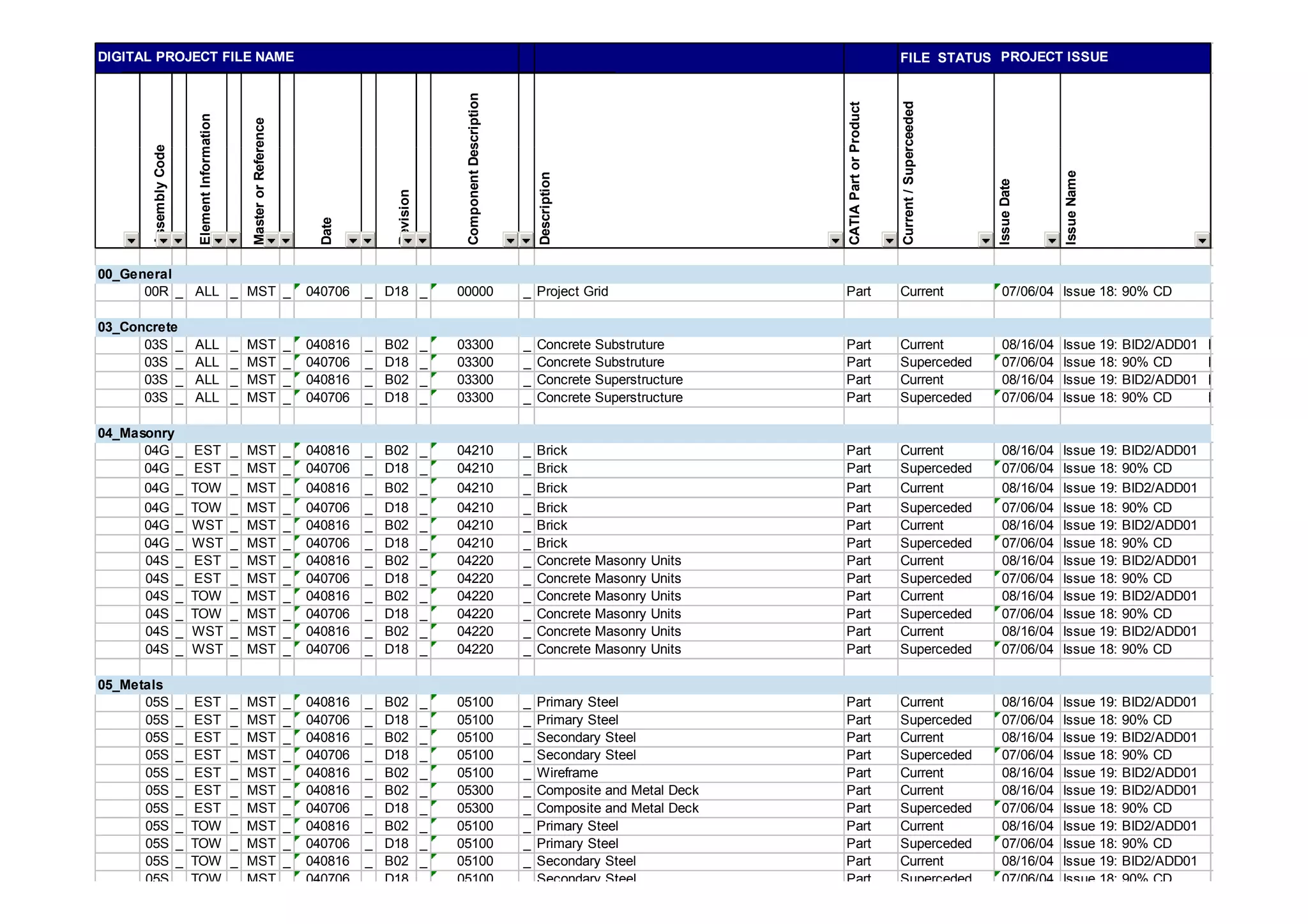

FILE STATUS
e
mation
rence
scription
Product
rceeded
PROJECT ISSUEDIGITAL PROJECT FILE NAME
112
AssemblyCode
ElementInform
MasterorRefer
Date
Revision
ComponentDes
Description
CATIAPartorP
Current/Super
IssueDate
IssueName
00_General
00R _ ALL _ MST _ 040706 _ D18 _ 00000 _ Project Grid Part Current 07/06/04 Issue 18: 90% CD
03_Concrete
03S _ ALL _ MST _ 040816 _ B02 _ 03300 _ Concrete Substruture Part Current 08/16/04 Issue 19: BID2/ADD01
03S ALL MST 040706 D18 03300 C t S b t t P t S d d 07/06/04 I 18 90% CD03S _ ALL _ MST _ 040706 _ D18 _ 03300 _ Concrete Substruture Part Superceded 07/06/04 Issue 18: 90% CD
03S _ ALL _ MST _ 040816 _ B02 _ 03300 _ Concrete Superstructure Part Current 08/16/04 Issue 19: BID2/ADD01
03S _ ALL _ MST _ 040706 _ D18 _ 03300 _ Concrete Superstructure Part Superceded 07/06/04 Issue 18: 90% CD
04_Masonry
04G _ EST _ MST _ 040816 _ B02 _ 04210 _ Brick Part Current 08/16/04 Issue 19: BID2/ADD01
04G _ EST _ MST _ 040706 _ D18 _ 04210 _ Brick Part Superceded 07/06/04 Issue 18: 90% CD
04G _ TOW _ MST _ 040816 _ B02 _ 04210 _ Brick Part Current 08/16/04 Issue 19: BID2/ADD01
04G _ TOW _ MST _ 040706 _ D18 _ 04210 _ Brick Part Superceded 07/06/04 Issue 18: 90% CD
04G _ WST _ MST _ 040816 _ B02 _ 04210 _ Brick Part Current 08/16/04 Issue 19: BID2/ADD01
04G _ WST _ MST _ 040706 _ D18 _ 04210 _ Brick Part Superceded 07/06/04 Issue 18: 90% CD
04S EST MST 040816 B02 04220 Concrete Masonry Units Part Current 08/16/04 Issue 19: BID2/ADD01_ _ _ _ _ _ y
04S _ EST _ MST _ 040706 _ D18 _ 04220 _ Concrete Masonry Units Part Superceded 07/06/04 Issue 18: 90% CD
04S _ TOW _ MST _ 040816 _ B02 _ 04220 _ Concrete Masonry Units Part Current 08/16/04 Issue 19: BID2/ADD01
04S _ TOW _ MST _ 040706 _ D18 _ 04220 _ Concrete Masonry Units Part Superceded 07/06/04 Issue 18: 90% CD
04S _ WST _ MST _ 040816 _ B02 _ 04220 _ Concrete Masonry Units Part Current 08/16/04 Issue 19: BID2/ADD01
04S _ WST _ MST _ 040706 _ D18 _ 04220 _ Concrete Masonry Units Part Superceded 07/06/04 Issue 18: 90% CD
05_Metals
05S _ EST _ MST _ 040816 _ B02 _ 05100 _ Primary Steel Part Current 08/16/04 Issue 19: BID2/ADD01
05S _ EST _ MST _ 040706 _ D18 _ 05100 _ Primary Steel Part Superceded 07/06/04 Issue 18: 90% CD
05S _ EST _ MST _ 040816 _ B02 _ 05100 _ Secondary Steel Part Current 08/16/04 Issue 19: BID2/ADD01
05S _ EST _ MST _ 040706 _ D18 _ 05100 _ Secondary Steel Part Superceded 07/06/04 Issue 18: 90% CD
05S EST MST 040816 B02 05100 Wireframe Part Current 08/16/04 Issue 19: BID2/ADD01
BRE398: Building Information ModelingMTECH Confidential– 2005 Page
05S _ EST _ MST _ 040816 _ B02 _ 05100 _ Wireframe Part Current 08/16/04 Issue 19: BID2/ADD01
05S _ EST _ MST _ 040816 _ B02 _ 05300 _ Composite and Metal Deck Part Current 08/16/04 Issue 19: BID2/ADD01
05S _ EST _ MST _ 040706 _ D18 _ 05300 _ Composite and Metal Deck Part Superceded 07/06/04 Issue 18: 90% CD
05S _ TOW _ MST _ 040816 _ B02 _ 05100 _ Primary Steel Part Current 08/16/04 Issue 19: BID2/ADD01
05S _ TOW _ MST _ 040706 _ D18 _ 05100 _ Primary Steel Part Superceded 07/06/04 Issue 18: 90% CD
05S _ TOW _ MST _ 040816 _ B02 _ 05100 _ Secondary Steel Part Current 08/16/04 Issue 19: BID2/ADD01
05S TOW MST 040706 D18 05100 Secondary Steel Part Superceded 07/06/04 Issue 18: 90% CD
TopicsTopics
Building Construction Challenges
Building Information Modeling
3D BIM
3D Design / MEP Designg / g
Realistic Simulation
4D BIM4D BIM
5D BIM
Value of BIM to the industryValue of BIM to the industry
BRE398: Building Information Modeling
Values of BIMValues of BIM
BIM i t it f h i d i f tiBIM is a one stop repository for such varied information
as supplier data, manufacturer information, costing,
dimensional data and component specifications.p p
Consolidation of data allows the project managers to
provide clients with value added services. These include
information on lighting heat power usage furnitureinformation on lighting, heat, power usage, furniture
and post occupancy requirements (Howard, 2008).
Liston and Fischer (2010) believe that data attached toListon and Fischer (2010) believe that data attached to
individual components increases accuracy of pricing
and bidding. Construction schedules can be optimized in
the face of constant changes in availability andthe face of constant changes in availability and
delivery of raw materials and design changes.
BRE398: Building Information Modeling

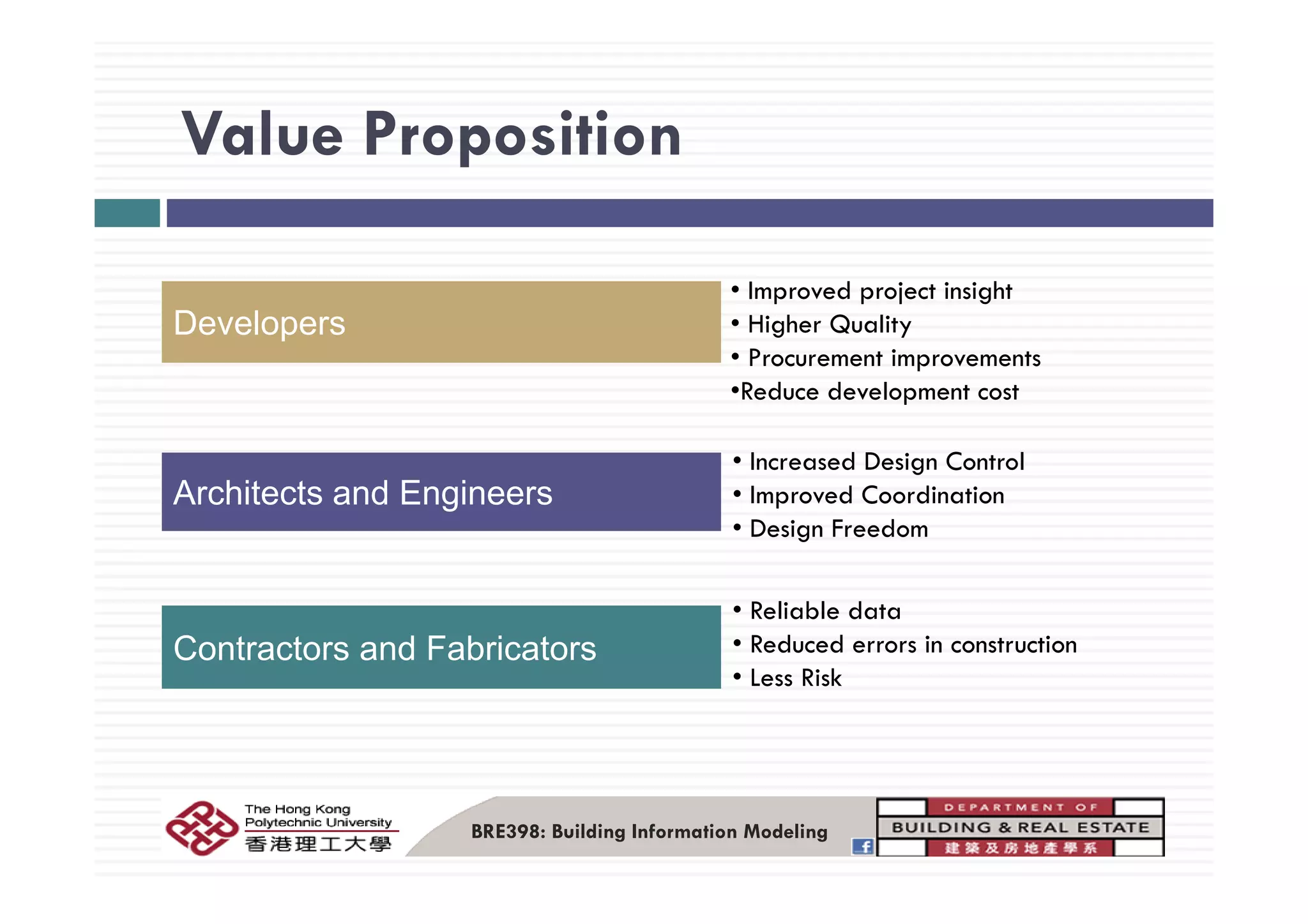

Value PropositionValue Proposition
Developers
• Improved project insight
• Higher Quality
• Procurement improvements• Procurement improvements
•Reduce development cost
• Increased Design Control
Architects and Engineers
• Increased Design Control
• Improved Coordination
• Design Freedom
Contractors and Fabricators
• Reliable data
• Reduced errors in construction
L Ri k• Less Risk
BRE398: Building Information Modeling

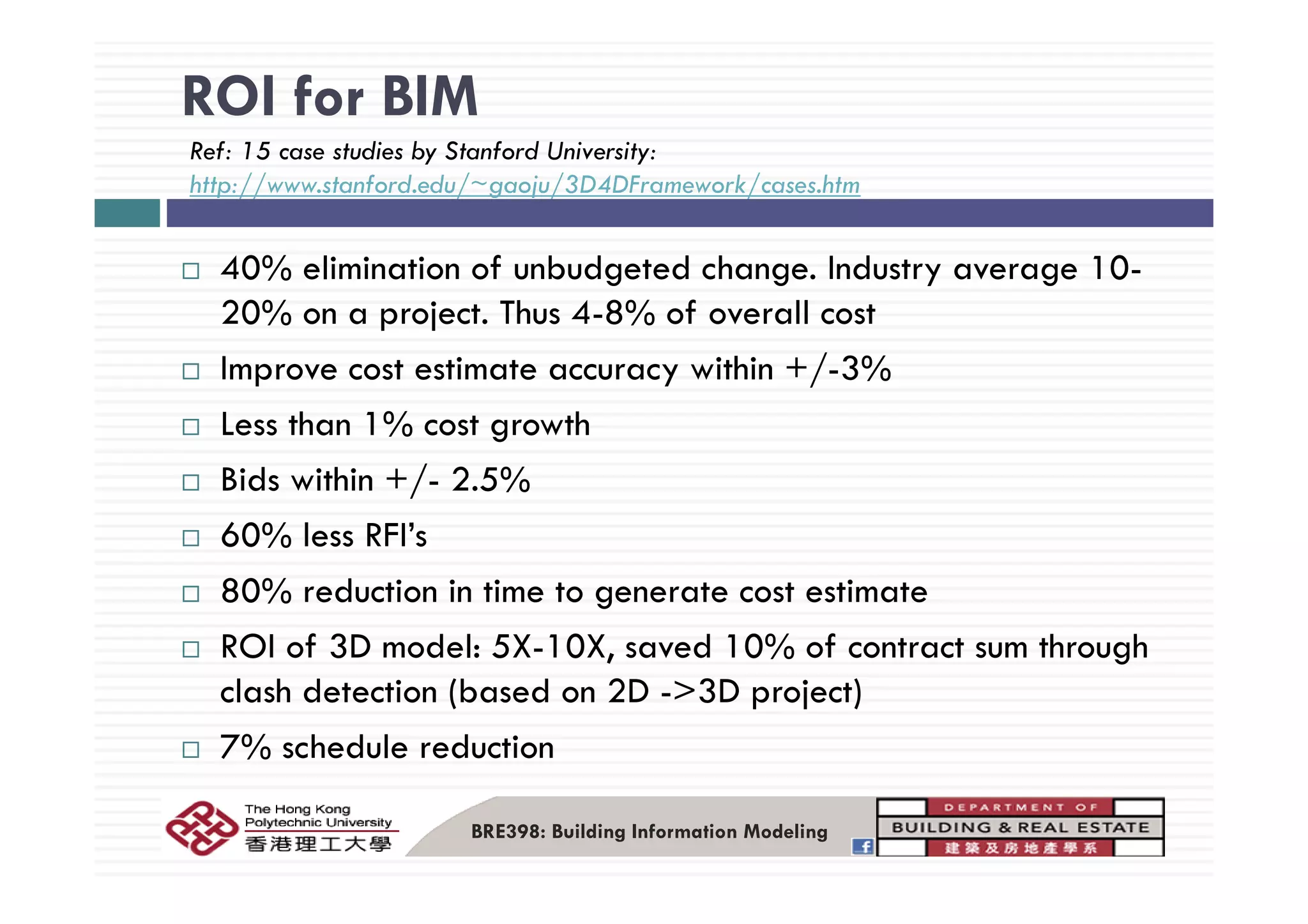

ROI for BIM
R f 15 t di b St f d U i itRef: 15 case studies by Stanford University:
http://www.stanford.edu/~gaoju/3D4DFramework/cases.htm
40% elimination of unbudgeted change. Industry average 10-
20% on a project. Thus 4-8% of overall cost
I i i hi / 3%Improve cost estimate accuracy within +/-3%
Less than 1% cost growth
Bids within +/- 2.5%
60% less RFI’s
80% reduction in time to generate cost estimate
ROI of 3D model: 5X-10X, saved 10% of contract sum through
clash detection (based on 2D ->3D project)
7% schedule reduction
BRE398: Building Information Modeling

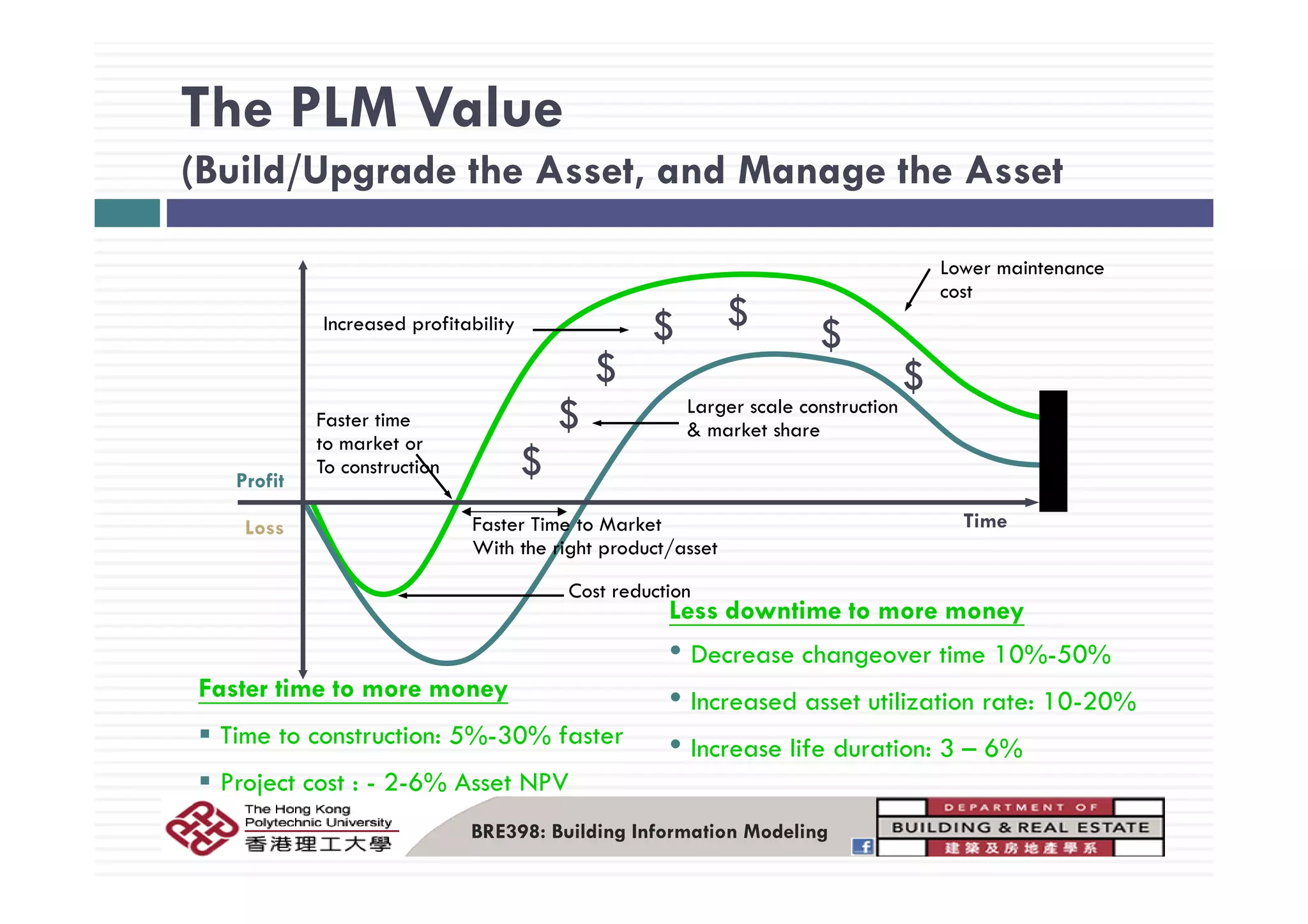

The PLM Value
(Build/Upgrade the Asset, and Manage the Asset
Increased profitability
$
$ $
$
Lower maintenance
cost
Faster time
to market or
T t ti
Larger scale construction
& market share
$
$
$ $
To construction $Profit
Loss TimeFaster Time to Market
With the right product/asset
Cost reduction
Less downtime to more money
• Decrease changeover time 10%-50%
Faster time to more money
Time to construction: 5%-30% faster
P j t t 2 6% A t NPV
• Increased asset utilization rate: 10-20%
• Increase life duration: 3 – 6%
BRE398: Building Information Modeling
Project cost : - 2-6% Asset NPV
118
BRE398: Building Information Management
Questions & Answers
stephenau@mtech.com.hk
BRE398: Building Information Modelling
ReferencesReferences
BRE398: Building Information Modeling

Building information modeling & value to the AEC industry Part 1 v1

  • 1.
    Building Information Modeling& Value to the AEC Industry Part 1Part 1 Stephen AUp Sept 26, 2013 Lecture Class BRE398: Building Information Modeling BRE398: Building Information Modeling
  • 2.
    TopicsTopics Building Construction Challenges BuildingInformation Modelingg g 3D BIM Architectural / Structural / MEP DesignArchitectural / Structural / MEP Design Realistic Simulation 4D BIM4D BIM 5D BIM V l f BIM t th i d tValue of BIM to the industry BRE398: Building Information Modeling
  • 3.
    Lecture Objectives andResultsLecture Objectives and Results Objectives The challenges of Building Construction Industry To understand how BIM technology improve the building construction industry The value of using BIM for the industry QuestionQuestion What are the benefits and limitation in applying BIM technology to the industry?technology to the industry? BRE398: Building Information Modeling
  • 4.
    TopicsTopics Building Construction Challenges BuildingInformation Modelingg g 3D BIM Architectural / Structural / MEP DesignArchitectural / Structural / MEP Design Realistic Simulation 4D BIM4D BIM 5D BIM V l f BIM t th i d tValue of BIM to the industry BRE398: Building Information Modeling
  • 5.
    5 What doe thebuilding look like? H h d it t?How much does it cost? When will it be finish? BRE398: Building Information Modeling
  • 6.
    Construction Mega-Trendsg Gl bl i b % f $ 2 Construction Industry Growth drives Global Economy Global construction to grow by 67% from $7.2 trillion today to $12 trillion in 2020. Growth in China, India and the US will generate 54% of the $4 8 trillionIndia and the US will generate 54% of the $4.8 trillion increase in global construction output. A total of $97 7 trillion will be spent on constructionA total of $97.7 trillion will be spent on construction globally during the next decade and by 2020 construction will account for 13.2% of world GDP. By 2020 emerging markets will account for 55% of global construction, up from 46% today. Construction will make up 16.5% of GDP in emerging markets by 2020, up from 14.7% in 2010. R f Gl b l C i 2020 Gl b l C i P i d O f d E i BRE398: Building Information Modeling Ref: Global Construction 2020, Global Construction Perspectives and Oxford Economics
  • 7.
    The AEC IndustrialTrendThe AEC Industrial Trend Project Innovation – Technology, Environmental Complexity Design 全 球p y g Time to Delivery C t C t l 球 最 環 Cost Control Global Collaboration 環 保 大廈 Pre-fabricate Construction Early and Off Shore Procurement 廈 垃 圾發 Early and Off Shore Procurement Rapid ROI 發 電 BRE398: Building Information Modeling
  • 8.
    Challenges along aBuilding Project B ildi M difi ti Lifecycle Asset Development – EPC , Suppliers Building Modifications & Retrofits Data Handover 0.5 – 8 years Lifecycle 20 – 30 – 60 years Test &Test & Operations &Operations & PlanningPlanning DevelopmentDevelopment Test &Test & ValidationValidation ConstructionConstruction Operations &Operations & MaintenanceMaintenance DeDecommissioncommission Asset Maintenance- O/O BRE398: Building Information Modeling
  • 9.
    Building Project Management 9 BuildingProject Management What to Design? PProductroduct -Needs, Idea, Regulation,… How to Build? PPProcessProcess -Task, Role & Skill With What to Build? RRResourcesResources -Knowledge, Finance, Machinery People &Machinery, People & Technology
  • 10.
    Current Situation inthe AEC IndustryCurrent Situation in the AEC Industry Product Life Cycle Feasibility Select Define Execute Operate Owner Owner Owner Contractor OwnerOwner Architect Architect Contractor Owner Front End Design (1) Front End Design (2) Engineering D i Maintain Design Procurement Construction & Procurement Unclear Weak Weak Resources Problem information Problems are pushed to next phase communication collaboration wastageProblem BRE398: Building Information Modeling 10
  • 11.
    Time FactorsTime Factors Projectclarity Communication is mainly by email, telephone ory y , p business meeting Time consuming in discussion & reinventTime consuming in discussion & reinvent Design data translation Design data re-define Too many design changes in construction stagesy g g g BRE398: Building Information Modeling
  • 12.
    Quality Factors –Multi-disciplines Conflict
  • 13.
    • Cost FactorsCostFactors Change orders cost 5 times the value of the change approvedChange orders cost 5 times the value of the change approved 90% of large construction projects have cost overruns averaging 28% Low Cost Estimates Due To : Inadequate preliminary engineeringInadequate preliminary engineering Insufficient contingencies for unexpected incidents Incentives to Underestimate Material Waste : Poor site supervision Poor planning Improper storage B i k t bi t tBricks, concrete are biggest waste 1-10% of weight of material leaves site as waste 9% in one study, 10-20% in another Example: 17% of plasterboard delivered to construction sites leaves as waste Cost Overruns: 30% of cost overruns are avoidable Average cost overrun is 5-8% Ref: Stanford University Center For Integrated Facility Engineering (CIFE) Statistics For Current U.S. Construction Industry Inefficiencies BRE398: Building Information Modeling y
  • 14.
    Cost Factor -Increasing cost of correction Concept Specification Engineering Development Tendering Process Planning Construction 1000 10 100 * Fred Y Phillips Market Oriented Technology Management 1 0 BRE398: Building Information Modeling www.iconasolutions.com Fred Y Phillips, Market Oriented Technology Management
  • 15.
    Limitation of 2DDrawing (1/2)Limitation of 2D Drawing (1/2) The reader must interpret 2D Drawings and recreate design intend b their knowledge and experience. These drawings can run into hundreds of separate documents, which make it very difficult to gain an overview of operations resulting in inconsistencies (Stebbins, 2007). CAD documents exclude information required for evaluating a design and monitoring construction activities (Oskouie et al., 2010). . BRE398: Building Information Modeling
  • 16.
    Limitation of 2DDrawing (2/2)Limitation of 2D Drawing (2/2) Bids and contract documents, bill of materials (BOM), time frame specifications, costs, labelling as well as installing and maintaining guides are also not included. According to Knight (2008), the growing complexities of design models threaten to makecomplexities of design models threaten to make CAD drawings insufficient and redundant. BRE398: Building Information Modeling
  • 17.
    Business ChallengesBusiness Challenges Missedschedule d dli Too many outstanding i d RFI Poor decision-making deadlines due to resource under estimation issues and RFI insufficient phase/gate reviews due to use of outdated and/or wrong information Optimize the deployment and Ensure delivery of projects within Ensure streamline consumption of enterprise resources within performance and timing guidelines project handshake and correct outcome BRE398: Building Information Modeling guidelines
  • 18.
    Business ChallengesBusiness Challenges Difficultyfinding project information Unpredictable results due to inconsistent Poor management visibility because it is stored in multiple databases or persons’ desktops due to inconsistent processes and lack of deliverable templates visibility of troubled projects that require corrective actionaction Improve traceability of Ensure projects are running based on Improve visibility through project project information and data based on company standards and processes through project dashboards and reporting BRE398: Building Information Modeling processes
  • 19.
    Key Drivers ofConstruction Productivity Shifting construction activity to the factory affords better quality control, optimized production, lower cost labor and greater safety Field work shifts to coordinationsafety. Field work shifts to coordination, assembly, and unique conditions. Improving productivity in construction : prefabrication/modularization is seeing a renaissance as technologies, such as BIM, have enabled better integration ofhave enabled better integration of components. Out of over 800 architecture, engineering and contracting (AEC) professionals surveyed: • 66% report that project schedules are decreased - 35% by four weeks or more • 77% report that construction site waste is decreased - 44% by 5% or more BRE398: Building Information Modeling is decreased - 44% by 5% or more
  • 20.
    Key Drivers ofConstruction Productivity I f ti T h lInformation Technology: Construction simulation for better planning Technology in the field for fast and accurate problem-solving Smart Supplies, Smart Materials,Smart Supplies, Smart Materials, Smart Buildings, Smart Cities… Virtually-building allows problem-solving, optimizing projects in advance of actualoptimizing projects in advance of actual construction so that fewer issues arise in the field. C BIM l i lCurrent BIM solutions struggle to support this change BRE398: Building Information Modeling
  • 21.
    SHoP ConstructionSHoP Construction Bi Ch llBusiness Challenge Deliver 12,000 pre-weathered façade panels, with no two alikealike Solution Using the BIM application linkUsing the BIM application, link construction planning directly to CNC fabrication. Develop a workflow toDevelop a workflow to automate panel unfolding and fabrication tickets with bending schedules. Develop a unitized system with color-coded installation instructions. BRE398: Building Information Modeling
  • 22.
    Industry Equity |What Does The AEC d l hIndustry Value The Most? V l f O V l f AECValue for Owner Value for AEC Capital Lower operating costs On time p efficiency On budget Sustainability Safety Quality of Experience Less risk BRE398: Building Information Modeling
  • 23.
    TopicsTopics Building Construction Challenges BuildingInformation Modeling 3D BIM Architectural / Structural / MEP Design/ / g Realistic Simulation 4D BIM4D BIM 5D BIM Value of BIM to the industryValue of BIM to the industry BRE398: Building Information Modeling
  • 24.
    3D BIM BRE398: BuildingInformation Modelling
  • 25.
    The Power ofInformation TechnologyThe Power of Information Technology C t Digitization Cost Vi li i R h InternetVisualization Reach TimeQuality BRE398: Building Information Modeling Timey
  • 26.
    Building Information ModelingBuildingInformation Modeling B ildi I f ti M d li (BIM) hi h h b d fi dBuilding Information Modeling (BIM) which has been defined as “a digital representation or visualisation of physical and functional characteristics of a facility. In addition BIM serves as a shared knowledge resource for information about a facility forming a reliable basis for decisions during its life- cycle from inception onward” (Eastman and Tiecholz, 2008).y p ( , ) From this definition it is evident that BIM is a multipurpose tool facilitating design and development, data management and planning functions.and planning functions. The drivers for BIM are the exigencies of a fast expanding, increasingly complex construction industry, the need for more d i i d di i ll k h ld dproductivity and co-ordination amongst all stakeholders and reducing variance between customer expectation and final product (Tolman, 2008). BRE398: Building Information Modeling
  • 27.
    Purposes of theBIM Model (1/2)Purposes of the BIM Model (1/2) fEstablish a single primary repository for critical architectural geometry and information Facilitate rapid design changes that are automatically reflected in the ancillary documents Provide automatically coordinated drawings to the architects Facilitate full 3D modeling of structure by the structural engineers Eliminate conflicts that typically arise with the integration of MEP BRE398: Building Information Modeling
  • 28.
    Purposes of theBIM Model (2/2)Purposes of the BIM Model (2/2) Allow automated reporting of certain quantities for the QS Provide an easily accessible source of accurate information for tenderingg Provide a constructionally accurate rendering model All t t t i li t tiAllow contractors to visualize construction sequencing and anticipate possible delays Become the basis for facilities management work after construction BRE398: Building Information Modeling
  • 29.
    Design + Documentation+ CommunicationDesign Documentation Communication Ref: Paul Seletsky,2005 ‘Digital Design and the Age of Building Simulation’ ACEbytes Viewpoint #19 www.aecbytes.com/viewpoint/issue_19_pr.ht
  • 30.
    BIM Model forBuilding DesignBIM Model for Building Design Ref: Paul Seletsky,2005 ‘Digital Design and the Age of Building Simulation’ ACEbytes Viewpoint #19 www.aecbytes.com/viewpoint/issue_19_pr.ht
  • 31.
    Maturity Level ofBIMMaturity Level of BIM A maturity model was developed by the UK Department of Business Innovations and Skills (BIS). BIS defined the levels from 0 through 3. A majority of the market is still working with Level 1 processes, and the best in class are experiencing significant benefits in Level 2.
  • 32.
    Economic Functional WorkingTender & Construction + O Building Information Modeling Lifecycle Study Design g Drawing Tender & Award Construction + Commission Operate Procurement Pre-lease Sales & Marketing 2D Design Drawing from Consultants Marketing Interactive 3D Rendering Simulation model Extraction of Building Quantities from the As- Design BIM Model Linked facility management information to As- As- As-Built Design BIM Model Linked construction schedule with As-Design BIM model As-Built BIM model Design BIM Model As- Constructed BIM Model As-Built BIM Model 3D collision checking report
  • 33.
    Quebec Hydro PowerPlant 33 BRE398: Building Information ModelingMercier_Demo_AnimatedwithText.avi
  • 35.
    BIM Solutions Bridging thegap between concept design & construction BIM Solutions Common understanding Bridging the gap between concept, design & construction Common understanding Informed decision makingInsight Conflict/issues brought openly to tableCollaboration Reduced risk/improved build quality Integration Confidence in achieving right first time Integration BRE398: Building Information Modeling www.iconasolutions.com g
  • 36.
    Exceeding Perceived Qualitytargets Innovation Exceeding Perceived Quality targets Innovation Early insight into the effects of design / construction variation Wh t if t di t fi d i ti l tiWhat-if studies to find innovative solutions Collaboration Informed decisions/unambiguous communication Complex issues visualised and shared between teamsp Reducing time/cost/risk C l d f d d l d lCritical engineering issues identified and resolved early Late discovery of costly production issues avoided BRE398: Building Information Modeling www.iconasolutions.com
  • 38.
    A hit tl / St t l / MEPArchitectural / Structural / MEP Design 3D Complex surface design Architectural and structural design Design Architectural and structural design MEP design Knowledge driven designg g BRE398: Building Information Modelling
  • 39.
    BIM Data StructuringBIMData Structuring 39 Assembled by a collection of files representing the physicalAssembled by a collection of files, representing the physical differentiation of building components Each consultant designs on respective component individually and concurrently ArchitectArchitect B. S. Engineer Structural Engineer BRE398: Building Information Modeling
  • 40.
    Model Progression SpecficationsModelProgression Specfications BRE398: Building Information Modeling
  • 41.
    3D Complex SurfaceDesign 41 3D Complex Surface Design All type of surface elements: from stylist to final surfaces ready for manufacturingready for manufacturing Memphis Canopy structure -p py Freeform metal finishes to manufacturing Building envelope and associated structural design
  • 42.
    Complex Surface Design 42 ComplexSurface Design Project: London 2012 Olympic Games Aquatic Centre Architect: Zaha Hadid MTECH Confidential– 2005 Page
  • 43.
    43 Complex Surface DesignComplexSurface Design Aquacenter1.aviAquacenter1.avi
  • 44.
    Parametric design 44 a ae c des g Architectural and structural design from2Dto3D-short.avi MTECH Confidential– 2005 Page
  • 45.
    Life-Build DesignLife BuildDesign BRE398: Building Information Management
  • 46.
    Values of BIMon DesignValues of BIM on Design BIM i t i t 2D d 3D d iBIM is a great improvement over 2D and 3D drawings since it enables designers to view the building from all angles (Bentley, 2009). This enables identification ofg ( y, ) any errors at an early stage which can then be corrected avoiding costly rework. O f h f i li i f BIM i i i fOne of the functionalities of BIM is incorporation of parametric design elements. Changes, additions or editions in any one parameter results in simultaneouseditions in any one parameter results in simultaneous reconfiguration of all other elements involved in the design including sectional and elevation dimensions, raw material requirements cost of production andmaterial requirements, cost of production and construction schedules and timelines (Emery, 2008) BRE398: Building Information Modeling
  • 47.
    MEP Design BRE398: BuildingInformation Modelling
  • 48.
    Process & SystemsDesign 48 Process & Systems Design 0) P li i L t 4) Process Planning Reaction planning0) Preliminary Layout Import Terrain data Building and Main equipment General Arrangement Preliminary weight estimates Cost Estimates Reaction planning Assembly hierarchy Association of resources Extract manufacturing document 1) Basic Design Define major system allocation Equipment Lists Preliminary BOM estimates Preliminary Weight estimates Pressure lose calculations 2) Detail Design Add secondary hangers & support Finish the detailing Define reaction spool 3) Manufacturing Deliverables Extract Mfg. Documents Assembly drawings Bill of Materials
  • 49.
    Equipment & SystemsDesign Ventilation systems HVAC Equipment & Systems Design Electrical Cabling Conceptual Layout System Routing Raceway & Conduit Drainage & Firing systems Piping y Hangers
  • 50.
    MEP System Assemblyand Design Collaboration D fi d b di i li f M&E tDefined by disciplines of M&E systems Enable collaborate design among Engineers Lighting Fixture Fire Services System Electricity System Plumbing Systemg y Drainage System
  • 51.
    MEP design –Routing of Electrical TrunkingMEP design Routing of Electrical Trunking 51 Route_Elect_800.aviRoute_Elect_800.avi BRE398: Building Information Modeling
  • 52.
    MEP design –Modify Electrical TrunkingMEP design Modify Electrical Trunking Route_Modify_800.aviRoute_Modify_800.avi
  • 53.
    Space reservation andDesign for 53 MEP systems & equipment XSteel CATIA HVAC D i iHVAC_Design.avi
  • 54.
    MEP Design -Design CollaborationMEP Design Design Collaboration HVAC system Fully co-ordinated Electrical system MEP design Plumbing system Drainage system
  • 55.
    MEP Design -Design Collaboration 55 MEP Design Design Collaboration MTECH Confidential– 2005 Page 机电系统同步設計 & 干涉检查
  • 56.
  • 57.
    57 BRE398: Building InformationModelingMTECH Confidential– 2005 Page The order of magnitude of information to achieve true 3D coordination of all elements of the project prior to tender
  • 58.
    MEP Design -Clash & Collision CheckingMEP Design Clash & Collision Checking Clash_final2.aviClash_final2.avi
  • 59.
    3D CSD CombineService Drawing 59 MTECH Confidential– 2005 Page
  • 60.
    2D-CSD Combined ServiceDrawing 60 MTECH Confidential– 2005 Page
  • 61.
    Benefits for CollaboratedDesignBenefits for Collaborated Design Perform digital design collaboration Increase information accuracy in early stagey y g UNCERTAINTY of information COST OF CHANGE BRE398: Building Information Modeling
  • 62.
    Maximize Variation toMinimize Deviation M cost Max. rangeofc Actual Cost Most stimatedr Most likely Es Feasibility Study Design Bid Construction Settlement Min. BRE398: Building Information Modeling Time
  • 63.
  • 64.
    Paradigm Transformation (1)ParadigmTransformation (1) Traditional 2D drawing New 3D Visualization Depending on imagination, skill and experience Viewing the same information without Independent works Accumulated errors imagination Collaborative workAccumulated errors Huge communication cost Many iterations Low communication cost Right at the First TimeMany iterations Right at the First Time BRE398: Building Information Modeling
  • 65.
    Challenges of DesignChangesChallenges of Design Changes The design for a hotel lobby shown here evolves into increasing levels of detail through the continuous iteration with schedule, goals andof detail through the continuous iteration with schedule, goals and project organization Main Body E Review work plan, team plan and goal plan Entrance Registration Seating Area Review work plan, team plan and goal plan Landing Doorway Foyer Desk Work space Office Coffee Bar Seating Toilet Review work plan, team plan and goal plan p Ref: George Elvin, Integrated Practice in Architecture, p.112, John Wiley & Sons, 2007
  • 66.
    Design Changes &Automatic UpdateDesign Changes & Automatic Update 66 Design & modeling with its geometrical definition linked contextually to other geometryDesign & modeling with its geometrical definition linked contextually to other geometry Changing context -> propagating change to linked geometry Process recorded in tree -> capture and reuse Advantages Automatic update parametric controlAdvantages : Automatic update, parametric control Process of modeling is recorded in tree BRE398: Building Information Modeling
  • 67.
    Design Change ofPublic Toilet 67 Design Change of Public Toilet WC_Update3_1024.avi
  • 68.
    Design Change ofStr ct ral Core 68 Design Change of Structural Core Corewall-Auto Update2 aviCorewall-Auto Update2.avi
  • 69.
    69 Design intend captureand Reuse M llion sho t a iMullion-short.avi
  • 70.
    Design Reuse -Catalogs 70 Design Reuse Catalogs Arch, structural, MEP catalogs Quick reuse and build-up of standardized designQuick reuse and build up of standardized design by Catalogs User defined & Customization
  • 71.
    Reuse of SanitaryFitments and 71 Design Update Toilet_Auto Update_1280.avi
  • 72.
    Design Intent Capture& Reuse 72 Design Intent Capture & Reuse Flexible to customize building entities. E.g. columns, beams doors escalatorsbeams, doors, escalators, curtain walls. Embedding geometricEmbedding geometric elements, formulas, constraints, etc., for full Escalator Powercopy parametric control Capturing design intent and re-specify for reuse Modeling standard well controlled Curtain wall Powercopy
  • 73.
    73 Knowledge Base EngineeringDesignKnowledge Base Engineering Design StairStair--short.avishort.avi
  • 74.
  • 75.
    Drawing ProductionDrawing Production 2DDressup & Symbols2D Dressup & Symbols BRE398: Building Information Modeling
  • 76.
    Paradigm Transformation (2)ParadigmTransformation (2) Traditional No alternative New Multiple ideas Unknown impact analysis Time consuming Clear impact analysis by all stakeholders forg Huge amount of cost Limited performance right decision QuickLimited performance Almost at no cost Optimize performanceOptimize performance BRE398: Building Information Modeling
  • 77.
    3D Realistic Simulation StructuralAnalysis Di i l M kDigital Mockup Photo Realistic Rendering BRE398: Building Information Modelling
  • 78.
    Structural Analysis –Data Interoperability78 St li C ll b tiStreamlines Collaboration between Architects and Engineersg Live integration with Market leading Structural Analysis tools R b tRobot ETABS SAP2000 IFC Export Interoperate between IGES, STEP, 3D Dxf and Dwg (Autocad), SDNFSDNF CIS/2 (design data) export BRE398: Building Information Modeling
  • 79.
    Structural Analysis –Data Integration 79 Structural Analysis Data Integration Drawings Specification Bidding Des autocad® 3D Master E i i Bidding sign&Co Model Engineering onstruction STEP CIS/2 Fluent Fabrication nProcess Fluent … Construction
  • 80.
    Structural Analysis inCivil Engineering
  • 81.
    Rendering & VisualizationRendering& Visualization BRE398: Building Information Modeling MTECH Confidential– 2005 Page 81
  • 82.
    Rendering & VisualizationRendering& Visualization BRE398: Building Information Modeling MTECH Confidential– 2005 Page 82
  • 83.
    Rendering & VisualizationRendering& Visualization BRE398: Building Information Modeling MTECH Confidential– 2005 Page 83
  • 84.
    Rendering & VisualizationRendering& Visualization BRE398: Building Information Modeling MTECH Confidential– 2005 Page 84
  • 85.
    Virtual Prototyping byDigital MockUp (DMU)85 Typical AEC projects are 2D basedTypical AEC projects are 2D based 2D does not represent the reality and is subject to mis- understandingunderstanding Owner facing •Critical decision information •Marketing BRE398: Building Information Modeling
  • 86.
    Virtual Prototyping byDigitalVirtual Prototyping by Digital MockUpMockUp (DMU)(DMU)Virtual Prototyping by DigitalVirtual Prototyping by Digital MockUpMockUp (DMU)(DMU) accommo aviaccommo aviaccommo.aviaccommo.avi
  • 87.
    Design for Operationsand Maintenance87 T i l AEC j t t f ll ti i d fTypical AEC projects not fully optimized for maintenance and operations BIM supports design optimization for operations andBIM supports design optimization for operations and maintenance The Virtual Prototype serves as the basis for operations and maintenance simulation during the design phase BRE398: Building Information Modeling
  • 88.
    Design for Operationsand MaintenanceDesign for Operations and Maintenance mainte.avimainte.avi BRE398: Building Information Modeling
  • 89.
    Values of BIMValuesof BIM According to Middlebrooks (2008), BIM promotes facility management. Facility personnel use BIM to access data stored in a single repository to prepare schedules, implement daily operations and make predictive and futuristic plans with regard to purchases and construction activities. BRE398: Building Information Modeling
  • 90.
    Lighting Realization, Analysis& Measurement Analyze and virtually validate innovative lighting systems Ph t t i l i t i i t lPhotometric, colorimetric virtual measurement and analysis Taking into account real measured opticalTaking into account real measured optical properties of materials, surfaces Y h 01 / 02 BRE398: Building Information Modeling Yacht01 / 02. wmv
  • 91.
    Visual Ergonomics forHK MTRVisual Ergonomics for HK MTR Geometry and artificial light sources Catalog of light sources Intensity distribution of source Measure optical property from material BRE398: Building Information Modeling Illuminance result for concourse
  • 92.
    Visual Ergonomics forHK MTRVisual Ergonomics for HK MTR BRE398: Building Information Modeling Luminance Analysis
  • 93.
    HVAC Engineering FluidDynamic /Simulation (1/2) W ll T Di ib i T C lWall Temperature Distribution Temperature Cut-planes Old Design Wall Temperature Distribution New Design BRE398: Building Information Modeling 93 .
  • 94.
    HVAC Engineering FluidDynamic /Simulation (2/2) Temperature Distribution (10 cm from floor) Flow patterns Summary: New design shows superior temperature uniformity; shown in these animations (t = 0 to 80 seconds). Temperature Distribution (10 cm from floor) Flow patterns Sanyo-floorcontours.avi Sanyo-streamlines.avi BRE398: Building Information Modeling .
  • 95.
    Life-Like ExperienceLife LikeExperience Value proposition : improve design/styling by submitting it to « experience » trial increase sales by providing customers with experience and vivid 3d graphics While realistic rendering used to be the only focus, « life-like » experience becomes a growing complement of the design/planning phase Virtools format is ideal for large deployement, high realism, entertaining experience BRE398: Building Information Modeling
  • 96.
    Application of Life-LikeExperienceApplication of Life Like Experience City / Urban Planning Realistic experience / simulation Interior / Exterior Design Realistic experience / simulationp / Large model visualization Realistic experience / simulation 3D option simulation Virtual Showroom Entertaining experience T i i M i t & M it iEntertaining experience Wide range of deployment Training, Maintenance & Monitoring Interactive 3D application Various input device support
  • 97.
    As-Built BIM ModelAsBuilt BIM Model Properties selling & rental Interior design Virtual show room Properties management Virtool_ferdinand.aviVirtool_ferdinand.avi
  • 98.
    Shopping Mall ConfiguratorShoppingMall Configurator BRE398: Building Information Modeling 98
  • 99.
  • 100.
    Values of BIMValuesof BIM BIM allows visualization of form with some resemblance to realities (Manning and Messner, 2008). This allows evaluation of both aesthetic and functional features. Thus even non – technical stakeholders can easily understand these models. BIM reduces safety barriers which in turn reduceBIM reduces safety barriers which in turn reduce insurance costs, legal fees and professional liabilities.liabilities. BRE398: Building Information Modeling
  • 101.
    4D BIM =3D + Schedule (Time) The construction of the 4D models enables the various participants (from architects, designers, contractors to owners) of a construction project, to visualize the entire duration of a series of events and display the progress of construction activities through the life time of the project. This BIM-centric approach towardsp j pp project management technique has a very high potential to improve the project management and delivery of construction project, of any size or complexity.project, of any size or complexity. BRE398: Building Information Modelling
  • 102.
    Construction Sequencing – Scheduling& Simulation Linking to Microsoft Project and PrimaveraPrimavera Link tasks to sets of geometry “Play” construction schedule in time
  • 103.
    Construction SequencingConstruction Sequencing––q gq g Scheduling & SimulationScheduling & Simulation Construction 1024 x 768.aviConstruction 1024 x 768.avi BRE398: Building Information Modeling MTECH Confidential– 2005 Page Construction 1024 x 768.aviConstruction 1024 x 768.avi
  • 104.
    5D BIM =3D + schedule (time) + cost which refers to the intelligent linking of individual 3D CAD components or assemblies with schedule (time) constraint and cost-related information. Th f h 5D i i d d f h ddi i f f hThe use of the term 5D is intended to refer to the addition of fourth dimension: time and fifth dimension: cost to the 3D model, i.e. 5D is 3D + schedule (time) + cost. The construction of the 5D models enables the various participants ( from architects, designers, contractors to owners) of any construction project, to visualize the progress of construction activities and its related costs Mover time. This BIM-centric project management technique has a potential to vastly improves the project management and delivery of construction project of any size and complexity. BRE398: Building Information Modelling
  • 105.
    Data Extraction andReporting E l i h d l k i l i ibEvery element in the model knows its name, location, attribute set By-attribute and by-feature model search Taking Measurements: Dimensions Distance Coordinates Area Volume Batch Dimensional Data ExtractionBatch Dimensional Data Extraction HKIS Standard
  • 106.
  • 107.
    Simple MaterialsSimple Materials BRE398:Building Information Modeling
  • 108.
    Multiply MaterialsMultiply Materials BRE398:Building Information Modeling
  • 109.
    Ply-by-Ply Top andBottom ControlPly by Ply Top and Bottom Control 109 BRE398: Building Information Management
  • 110.
    Cost itemsCost items BRE398:Building Information Modeling 110
  • 111.
    Door 1024 x768.avi
  • 112.
    FILE STATUS e mation rence scription Product rceeded PROJECT ISSUEDIGITALPROJECT FILE NAME 112 AssemblyCode ElementInform MasterorRefer Date Revision ComponentDes Description CATIAPartorP Current/Super IssueDate IssueName 00_General 00R _ ALL _ MST _ 040706 _ D18 _ 00000 _ Project Grid Part Current 07/06/04 Issue 18: 90% CD 03_Concrete 03S _ ALL _ MST _ 040816 _ B02 _ 03300 _ Concrete Substruture Part Current 08/16/04 Issue 19: BID2/ADD01 03S ALL MST 040706 D18 03300 C t S b t t P t S d d 07/06/04 I 18 90% CD03S _ ALL _ MST _ 040706 _ D18 _ 03300 _ Concrete Substruture Part Superceded 07/06/04 Issue 18: 90% CD 03S _ ALL _ MST _ 040816 _ B02 _ 03300 _ Concrete Superstructure Part Current 08/16/04 Issue 19: BID2/ADD01 03S _ ALL _ MST _ 040706 _ D18 _ 03300 _ Concrete Superstructure Part Superceded 07/06/04 Issue 18: 90% CD 04_Masonry 04G _ EST _ MST _ 040816 _ B02 _ 04210 _ Brick Part Current 08/16/04 Issue 19: BID2/ADD01 04G _ EST _ MST _ 040706 _ D18 _ 04210 _ Brick Part Superceded 07/06/04 Issue 18: 90% CD 04G _ TOW _ MST _ 040816 _ B02 _ 04210 _ Brick Part Current 08/16/04 Issue 19: BID2/ADD01 04G _ TOW _ MST _ 040706 _ D18 _ 04210 _ Brick Part Superceded 07/06/04 Issue 18: 90% CD 04G _ WST _ MST _ 040816 _ B02 _ 04210 _ Brick Part Current 08/16/04 Issue 19: BID2/ADD01 04G _ WST _ MST _ 040706 _ D18 _ 04210 _ Brick Part Superceded 07/06/04 Issue 18: 90% CD 04S EST MST 040816 B02 04220 Concrete Masonry Units Part Current 08/16/04 Issue 19: BID2/ADD01_ _ _ _ _ _ y 04S _ EST _ MST _ 040706 _ D18 _ 04220 _ Concrete Masonry Units Part Superceded 07/06/04 Issue 18: 90% CD 04S _ TOW _ MST _ 040816 _ B02 _ 04220 _ Concrete Masonry Units Part Current 08/16/04 Issue 19: BID2/ADD01 04S _ TOW _ MST _ 040706 _ D18 _ 04220 _ Concrete Masonry Units Part Superceded 07/06/04 Issue 18: 90% CD 04S _ WST _ MST _ 040816 _ B02 _ 04220 _ Concrete Masonry Units Part Current 08/16/04 Issue 19: BID2/ADD01 04S _ WST _ MST _ 040706 _ D18 _ 04220 _ Concrete Masonry Units Part Superceded 07/06/04 Issue 18: 90% CD 05_Metals 05S _ EST _ MST _ 040816 _ B02 _ 05100 _ Primary Steel Part Current 08/16/04 Issue 19: BID2/ADD01 05S _ EST _ MST _ 040706 _ D18 _ 05100 _ Primary Steel Part Superceded 07/06/04 Issue 18: 90% CD 05S _ EST _ MST _ 040816 _ B02 _ 05100 _ Secondary Steel Part Current 08/16/04 Issue 19: BID2/ADD01 05S _ EST _ MST _ 040706 _ D18 _ 05100 _ Secondary Steel Part Superceded 07/06/04 Issue 18: 90% CD 05S EST MST 040816 B02 05100 Wireframe Part Current 08/16/04 Issue 19: BID2/ADD01 BRE398: Building Information ModelingMTECH Confidential– 2005 Page 05S _ EST _ MST _ 040816 _ B02 _ 05100 _ Wireframe Part Current 08/16/04 Issue 19: BID2/ADD01 05S _ EST _ MST _ 040816 _ B02 _ 05300 _ Composite and Metal Deck Part Current 08/16/04 Issue 19: BID2/ADD01 05S _ EST _ MST _ 040706 _ D18 _ 05300 _ Composite and Metal Deck Part Superceded 07/06/04 Issue 18: 90% CD 05S _ TOW _ MST _ 040816 _ B02 _ 05100 _ Primary Steel Part Current 08/16/04 Issue 19: BID2/ADD01 05S _ TOW _ MST _ 040706 _ D18 _ 05100 _ Primary Steel Part Superceded 07/06/04 Issue 18: 90% CD 05S _ TOW _ MST _ 040816 _ B02 _ 05100 _ Secondary Steel Part Current 08/16/04 Issue 19: BID2/ADD01 05S TOW MST 040706 D18 05100 Secondary Steel Part Superceded 07/06/04 Issue 18: 90% CD
  • 113.
    TopicsTopics Building Construction Challenges BuildingInformation Modeling 3D BIM 3D Design / MEP Designg / g Realistic Simulation 4D BIM4D BIM 5D BIM Value of BIM to the industryValue of BIM to the industry BRE398: Building Information Modeling
  • 114.
    Values of BIMValuesof BIM BIM i t it f h i d i f tiBIM is a one stop repository for such varied information as supplier data, manufacturer information, costing, dimensional data and component specifications.p p Consolidation of data allows the project managers to provide clients with value added services. These include information on lighting heat power usage furnitureinformation on lighting, heat, power usage, furniture and post occupancy requirements (Howard, 2008). Liston and Fischer (2010) believe that data attached toListon and Fischer (2010) believe that data attached to individual components increases accuracy of pricing and bidding. Construction schedules can be optimized in the face of constant changes in availability andthe face of constant changes in availability and delivery of raw materials and design changes. BRE398: Building Information Modeling
  • 115.
    Value PropositionValue Proposition Developers •Improved project insight • Higher Quality • Procurement improvements• Procurement improvements •Reduce development cost • Increased Design Control Architects and Engineers • Increased Design Control • Improved Coordination • Design Freedom Contractors and Fabricators • Reliable data • Reduced errors in construction L Ri k• Less Risk BRE398: Building Information Modeling
  • 116.
    ROI for BIM Rf 15 t di b St f d U i itRef: 15 case studies by Stanford University: http://www.stanford.edu/~gaoju/3D4DFramework/cases.htm 40% elimination of unbudgeted change. Industry average 10- 20% on a project. Thus 4-8% of overall cost I i i hi / 3%Improve cost estimate accuracy within +/-3% Less than 1% cost growth Bids within +/- 2.5% 60% less RFI’s 80% reduction in time to generate cost estimate ROI of 3D model: 5X-10X, saved 10% of contract sum through clash detection (based on 2D ->3D project) 7% schedule reduction BRE398: Building Information Modeling
  • 117.
    The PLM Value (Build/Upgradethe Asset, and Manage the Asset Increased profitability $ $ $ $ Lower maintenance cost Faster time to market or T t ti Larger scale construction & market share $ $ $ $ To construction $Profit Loss TimeFaster Time to Market With the right product/asset Cost reduction Less downtime to more money • Decrease changeover time 10%-50% Faster time to more money Time to construction: 5%-30% faster P j t t 2 6% A t NPV • Increased asset utilization rate: 10-20% • Increase life duration: 3 – 6% BRE398: Building Information Modeling Project cost : - 2-6% Asset NPV
  • 118.
  • 119.
  • 120.
