ASSISTANT PROFESSOR  LPU, PUNJAB  Software Project Management
Till far we have studied  What’s a project? What makes software projects different Project Perspectives Software Management Basics
1.1  What is a Project? Project is a temporary endeavor undertaken to create a unique product or service.  Project is a well defined set of tasks or activities that must be completed in order to meet the project’s goal. Non routine tasks :  Planning reqd. Sp. Objective to be met/ sp. Products to be created Predetermined time span Work is done for others Work is carried out in several phases Resource constraints Projects could be large and/or complex
1.2  Project vs Programme Project is a nonrepetitive set of activities leading to singular product or service and gets over in a limited / finite time frame Great wall of China Suez Canal Taj Mahal Programme is a repetitive array of activities carried out on a longer/ indefinite time frame to accomplish many no of similar / dissimilar projects Identify :  project or programme ???? putting a robot vehicle on Mars to search for sign of life  Writing an operating system
1.3  Project Success or Failure A project success is usually measured in terms of whether it is completed within specified time and under stipulated budget If it exceeds uncontrollably it is termed as a failure. However there is more to a project’s success than just its completion within time and budget Meeting customer specifications Degree of customer satisfactions Level of success in the market place Result in greater revenue and profits
1.4 Software project vs other project  Invisibility,  A bridge or road can actually be seen. With software, progress is not immediately visible. Complexity,  Per dollar, pound or euro spent, software products contain more complexity than other engineered artefacts. Conformity,  Software developers have to conform to the requirements of human clients Flexibility,  The ease with which software can be changed is usually seen as one of its strengths.
1.5 Type of Software  System Software  Real time Software  Business Software Engg. N scientific Software Embedded Software PC based  Software Web based Software AI based Software Open source Software
1.6 Problem with software project  poor estimates and plans; lack of quality standards and measures; lack of guidance about making organizational decisions; lack of techniques to make progress visible; poor role definition – who does what? incorrect success criteria.
1.7  Why Projects need to be Managed ? Because resources are limited Because project has to be delivered within time and budget Therefore in order to maximise output (with regard to project delivery) with the limited input resource , managerial attention is needed.
1.8  Project Management (Defn.) PMI defines Project Management as the “Art of directing and coordinating human and material resources through out the life of a project by using modern management techniques to achieve predetermined objectives of scope, cost, time, quality and participant satisfaction
1.9 Activities in Software Project Management  There are four broad phases in any project life cycle  Preplanning--- Conceptualization,  Formulation and Selection (Project feasibility study, Project Scoping) Planning--- Task definition and break ups, resource estimation Scheduling and Control--- Resource allocation, task execution, feedback and review Implementation and Termination--- Project completion, closure and hand over.

1.10 Step Wise Project planning  1. Identify project objectives 2. Identify project infrastructure 3. Analyse project  characteristics 4. Identify products  and activities   5. Estimate effort  for activity   8. Review/ publicize plan   6. Identify activity risks   7. Allocate resources   9. Execute plan   10. Lower level planning   Review Lower level detail For each activity 0.Select project
A project scenario LPU Shopping mall Project Where to setup .. Which brand  Facilities  Stakeholders  Virtual money
Step 1 establish project scope and objectives 1.1 Identify objectives and measures of effectiveness ‘ how do we know if we have succeeded?’ 1.2 Establish a project authority ‘ who is the boss?’ 1.3 Identify all stakeholders in the project and their interests ‘ who will be affected/involved in the project?’ 1.4 Modify objectives in the light of stakeholder analysis ‘ do we need to do things to win over stakeholders?’ 1.5 Establish methods of communication with all parties ‘ how do we keep in contact?’
Step 2 Establish project infrastructure 2.1 Establish link between project and any strategic plan ‘ why did they want the project?’ 2.2 Identify installation standards and procedures ‘ what standards do we have to follow?’ Software life cycle?? 2.3. Identify project team organization ‘ where do I fit in?’
Step 3 Analysis of project characteristics 3.1 Distinguish the project as either objective or product-based. Is there more than one way of achieving success? 3.2 Analyse other project characteristics (including quality based ones) what is different about this project? Identify high level project risks ‘ what could go wrong?’ ‘ what can we do to stop it?’ Take into account user requirements concerning implementation Select development methodology and life cycle approach waterfall? Increments? Prototypes? Review overall resource estimates ‘ does all this increase the cost?’
Step 4 Identify project products and activities 4.1 Identify and describe project products - ‘what do we have to produce?’ What will be the deliverables
Products The result of an activity Could be (among other things) physical thing (‘installed pc’),  a document (‘logical data structure’) a person (‘trained user’) a new version of an old product (‘updated software’) The following are NOT normally products: activities (e.g. ‘training’, design, testing ) events (e.g. ‘interviews completed’) Products CAN BE  deliverable  or  intermediate
Product breakdown structure(PBS) Main product have sets of component products Product are grouped into those relating to the system as whole and those related to individual module. Project Products System Project Module Products Management Projects Progress  Report Module Code Module Design doc Tested integrated software Overall specification
Product description (PD) Product name/identity Description  - what is it? Derivation - what is it based on? Composition - what does it contain? Format: form of the product Relevant standards Quality criteria PDs can usually be re-used from one project to another.
Step 4 continued 4.2 Document Generic Product flows Need of other product to exit first before their creation Product flow diagram (PFD) Shows the order in which the products have to be completed. Defines a method of working   User Requirement  Overall system Specification Module design Integrated system test case Module code Integrated software
Step 4.3 Recognize product instances The  project breakdown structure  (PBS ) and  Project flow diagram  (PFD) will probably have identified generic products e.g. ‘software modules’ It might be possible to identify specific instances e.g. ‘module A’, ‘module B’ … But in many cases this will have to be left to later, more detailed, planning
4.4. Produce ideal activity network Identify the activities needed to create each product in the PFD More than one activity might be needed to create a single product Draw up activity network
An ‘ideal’ activity   Specify overall system Design Module A Design Integration  Test case Design Module B Code module  A Test Integration  software Code module  B
Step 4.5 Add check-points if needed Design module A Design module B Design system Design module C Code module A Code module B Code module C Test system Design module A Design module B Design system Design module C Code module A Code module B Code module C Test system Check-point put in a check point
Step 5:Estimate effort for each activity 5.1 Carry out bottom-up estimates Estimation of staff effort required  distinguish carefully between  effort  and  elapsed  time Effort :  Total number of staff-hours (or days etc) needed  to complete a task Elapsed: time between the start and end of the task. 5.2. Revise plan to create controllable activities break up very long activities into a series of smaller ones as we cant judge the status in long activities  bundle up very short activities (create check lists)
Step 6: Identify activity risks 6.1.Identify and quantify risks for activities damage if risk occurs (measure in time lost or money) likelihood if risk occurring Identify  the assumptions  : client requirement is clear  6.2. Plan risk reduction and contingency measures risk reduction: activity to stop risk occurring contingency: action if risk does occur Eg : contracting staff
6.3 Adjust overall plans and estimates to take account of risks e.g. add new activities which reduce risks associated with other activities e.g. training, pilot trials, information gathering
Step 7: Allocate resources 7.1 Identify and allocate resources to activities Eg staff need for each activities  7.2 Revise plans and estimates to take into account resource constraints More than one task assigned to staff  e.g. staff not being available until a later date non-project activities
Gantt charts Select subjects Design questionnaire Book machine Conduct tests Analyse results Week commencing 5 12 19 26 MARCH APRIL 9 16 Plan testing 2 Draft changes LT TA LT TA LT LT TA LT = lead tester TA = testing assistant
Step 8: Review/publicise plan 8.1 Review quality aspects of project plan Each task should have quality criteria Quality check has to be passed  8.2 Document plan and obtain agreement Proper documentation  Agreement of all parties  Step 9 and 10: Execute plan and create lower level plans
Step 9 &10: Execute plan/ low level of planning  Make provisional plan for distant task Execute plan
Step Wise Project planning  1. Identify project objectives 2. Identify project infrastructure 3. Analyse project  characteristics 4. Identify products  and activities   5. Estimate effort  for activity   8. Review/ publicize plan   6. Identify activity risks   7. Allocate resources   9. Execute plan   10. Lower level planning   Review Lower level detail For each activity 0.Select project
Draw up a product breakdown structure  of a computer.
a product breakdown structure  of a computer.
EXAMPLE There is a garden shed in a garden. The project is to dismantle the shed and reassemble it in the garden of a close neighbour. The shed has some rotten pieces. When the shed has been dismantled, these rotten pieces must be identified and replacements ordered from the company that supplied the original shed. New fixtures and fittings (screws, nuts and bolts, glue etc.) for all pieces will be needed, so a list of the requirements is to be made as the shed is dismantled. The neighbour has said that he will prepare the site for the shed’s new location as part of his own, separate project.
  product breakdown structure of the ‘old shed’
  Product Flow Diagram
Develop a project  planning for Course Scheduling System in LPU .  Proposed Plan  Course scheduling software is meant to create a schedule for courses in a department, given the preferences of professors and the information on available rooms and timeslots for courses

1 2. project management

  • 1.
    ASSISTANT PROFESSOR LPU, PUNJAB Software Project Management
  • 2.
    Till far wehave studied What’s a project? What makes software projects different Project Perspectives Software Management Basics
  • 3.
    1.1 Whatis a Project? Project is a temporary endeavor undertaken to create a unique product or service. Project is a well defined set of tasks or activities that must be completed in order to meet the project’s goal. Non routine tasks : Planning reqd. Sp. Objective to be met/ sp. Products to be created Predetermined time span Work is done for others Work is carried out in several phases Resource constraints Projects could be large and/or complex
  • 4.
    1.2 Projectvs Programme Project is a nonrepetitive set of activities leading to singular product or service and gets over in a limited / finite time frame Great wall of China Suez Canal Taj Mahal Programme is a repetitive array of activities carried out on a longer/ indefinite time frame to accomplish many no of similar / dissimilar projects Identify : project or programme ???? putting a robot vehicle on Mars to search for sign of life Writing an operating system
  • 5.
    1.3 ProjectSuccess or Failure A project success is usually measured in terms of whether it is completed within specified time and under stipulated budget If it exceeds uncontrollably it is termed as a failure. However there is more to a project’s success than just its completion within time and budget Meeting customer specifications Degree of customer satisfactions Level of success in the market place Result in greater revenue and profits
  • 6.
    1.4 Software projectvs other project Invisibility, A bridge or road can actually be seen. With software, progress is not immediately visible. Complexity, Per dollar, pound or euro spent, software products contain more complexity than other engineered artefacts. Conformity, Software developers have to conform to the requirements of human clients Flexibility, The ease with which software can be changed is usually seen as one of its strengths.
  • 7.

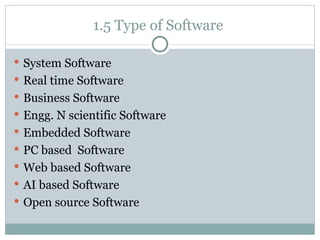

    1.5 Type ofSoftware System Software Real time Software Business Software Engg. N scientific Software Embedded Software PC based Software Web based Software AI based Software Open source Software
  • 8.
    1.6 Problem withsoftware project poor estimates and plans; lack of quality standards and measures; lack of guidance about making organizational decisions; lack of techniques to make progress visible; poor role definition – who does what? incorrect success criteria.
  • 9.
    1.7 WhyProjects need to be Managed ? Because resources are limited Because project has to be delivered within time and budget Therefore in order to maximise output (with regard to project delivery) with the limited input resource , managerial attention is needed.
  • 10.

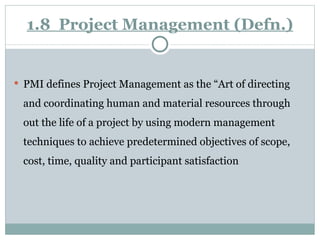

    1.8 ProjectManagement (Defn.) PMI defines Project Management as the “Art of directing and coordinating human and material resources through out the life of a project by using modern management techniques to achieve predetermined objectives of scope, cost, time, quality and participant satisfaction
  • 11.
    1.9 Activities inSoftware Project Management There are four broad phases in any project life cycle Preplanning--- Conceptualization, Formulation and Selection (Project feasibility study, Project Scoping) Planning--- Task definition and break ups, resource estimation Scheduling and Control--- Resource allocation, task execution, feedback and review Implementation and Termination--- Project completion, closure and hand over.
  • 12.
  • 13.
    1.10 Step WiseProject planning 1. Identify project objectives 2. Identify project infrastructure 3. Analyse project characteristics 4. Identify products and activities 5. Estimate effort for activity 8. Review/ publicize plan 6. Identify activity risks 7. Allocate resources 9. Execute plan 10. Lower level planning Review Lower level detail For each activity 0.Select project
  • 14.
    A project scenarioLPU Shopping mall Project Where to setup .. Which brand Facilities Stakeholders Virtual money
  • 15.
    Step 1 establishproject scope and objectives 1.1 Identify objectives and measures of effectiveness ‘ how do we know if we have succeeded?’ 1.2 Establish a project authority ‘ who is the boss?’ 1.3 Identify all stakeholders in the project and their interests ‘ who will be affected/involved in the project?’ 1.4 Modify objectives in the light of stakeholder analysis ‘ do we need to do things to win over stakeholders?’ 1.5 Establish methods of communication with all parties ‘ how do we keep in contact?’
  • 16.
    Step 2 Establishproject infrastructure 2.1 Establish link between project and any strategic plan ‘ why did they want the project?’ 2.2 Identify installation standards and procedures ‘ what standards do we have to follow?’ Software life cycle?? 2.3. Identify project team organization ‘ where do I fit in?’
  • 17.
    Step 3 Analysisof project characteristics 3.1 Distinguish the project as either objective or product-based. Is there more than one way of achieving success? 3.2 Analyse other project characteristics (including quality based ones) what is different about this project? Identify high level project risks ‘ what could go wrong?’ ‘ what can we do to stop it?’ Take into account user requirements concerning implementation Select development methodology and life cycle approach waterfall? Increments? Prototypes? Review overall resource estimates ‘ does all this increase the cost?’
  • 18.
    Step 4 Identifyproject products and activities 4.1 Identify and describe project products - ‘what do we have to produce?’ What will be the deliverables
  • 19.
    Products The resultof an activity Could be (among other things) physical thing (‘installed pc’), a document (‘logical data structure’) a person (‘trained user’) a new version of an old product (‘updated software’) The following are NOT normally products: activities (e.g. ‘training’, design, testing ) events (e.g. ‘interviews completed’) Products CAN BE deliverable or intermediate
  • 20.
    Product breakdown structure(PBS)Main product have sets of component products Product are grouped into those relating to the system as whole and those related to individual module. Project Products System Project Module Products Management Projects Progress Report Module Code Module Design doc Tested integrated software Overall specification
  • 21.
    Product description (PD)Product name/identity Description - what is it? Derivation - what is it based on? Composition - what does it contain? Format: form of the product Relevant standards Quality criteria PDs can usually be re-used from one project to another.
  • 22.
    Step 4 continued4.2 Document Generic Product flows Need of other product to exit first before their creation Product flow diagram (PFD) Shows the order in which the products have to be completed. Defines a method of working User Requirement Overall system Specification Module design Integrated system test case Module code Integrated software
  • 23.
    Step 4.3 Recognizeproduct instances The project breakdown structure (PBS ) and Project flow diagram (PFD) will probably have identified generic products e.g. ‘software modules’ It might be possible to identify specific instances e.g. ‘module A’, ‘module B’ … But in many cases this will have to be left to later, more detailed, planning
  • 24.
    4.4. Produce idealactivity network Identify the activities needed to create each product in the PFD More than one activity might be needed to create a single product Draw up activity network
  • 25.
    An ‘ideal’ activity Specify overall system Design Module A Design Integration Test case Design Module B Code module A Test Integration software Code module B
  • 26.
    Step 4.5 Addcheck-points if needed Design module A Design module B Design system Design module C Code module A Code module B Code module C Test system Design module A Design module B Design system Design module C Code module A Code module B Code module C Test system Check-point put in a check point
  • 27.
    Step 5:Estimate effortfor each activity 5.1 Carry out bottom-up estimates Estimation of staff effort required distinguish carefully between effort and elapsed time Effort : Total number of staff-hours (or days etc) needed to complete a task Elapsed: time between the start and end of the task. 5.2. Revise plan to create controllable activities break up very long activities into a series of smaller ones as we cant judge the status in long activities bundle up very short activities (create check lists)
  • 28.
    Step 6: Identifyactivity risks 6.1.Identify and quantify risks for activities damage if risk occurs (measure in time lost or money) likelihood if risk occurring Identify the assumptions : client requirement is clear 6.2. Plan risk reduction and contingency measures risk reduction: activity to stop risk occurring contingency: action if risk does occur Eg : contracting staff
  • 29.
    6.3 Adjust overallplans and estimates to take account of risks e.g. add new activities which reduce risks associated with other activities e.g. training, pilot trials, information gathering
  • 30.

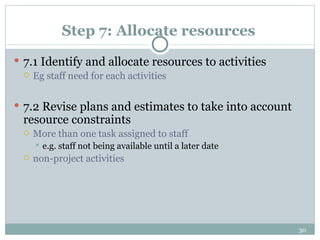

    Step 7: Allocateresources 7.1 Identify and allocate resources to activities Eg staff need for each activities 7.2 Revise plans and estimates to take into account resource constraints More than one task assigned to staff e.g. staff not being available until a later date non-project activities
  • 31.
    Gantt charts Selectsubjects Design questionnaire Book machine Conduct tests Analyse results Week commencing 5 12 19 26 MARCH APRIL 9 16 Plan testing 2 Draft changes LT TA LT TA LT LT TA LT = lead tester TA = testing assistant
  • 32.
    Step 8: Review/publiciseplan 8.1 Review quality aspects of project plan Each task should have quality criteria Quality check has to be passed 8.2 Document plan and obtain agreement Proper documentation Agreement of all parties Step 9 and 10: Execute plan and create lower level plans
  • 33.
    Step 9 &10:Execute plan/ low level of planning Make provisional plan for distant task Execute plan
  • 34.

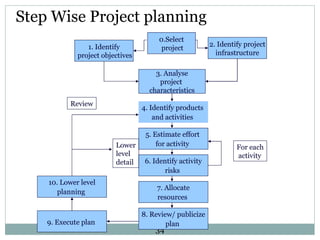

    Step Wise Projectplanning 1. Identify project objectives 2. Identify project infrastructure 3. Analyse project characteristics 4. Identify products and activities 5. Estimate effort for activity 8. Review/ publicize plan 6. Identify activity risks 7. Allocate resources 9. Execute plan 10. Lower level planning Review Lower level detail For each activity 0.Select project
  • 35.
    Draw up aproduct breakdown structure of a computer.
  • 36.
    a product breakdownstructure of a computer.
  • 37.

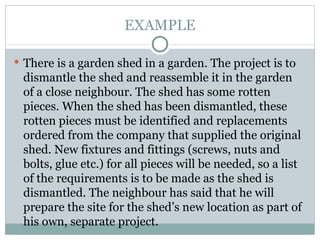

    EXAMPLE There isa garden shed in a garden. The project is to dismantle the shed and reassemble it in the garden of a close neighbour. The shed has some rotten pieces. When the shed has been dismantled, these rotten pieces must be identified and replacements ordered from the company that supplied the original shed. New fixtures and fittings (screws, nuts and bolts, glue etc.) for all pieces will be needed, so a list of the requirements is to be made as the shed is dismantled. The neighbour has said that he will prepare the site for the shed’s new location as part of his own, separate project.
  • 38.
      product breakdownstructure of the ‘old shed’
  • 39.
  • 40.
    Develop a project planning for Course Scheduling System in LPU . Proposed Plan Course scheduling software is meant to create a schedule for courses in a department, given the preferences of professors and the information on available rooms and timeslots for courses
