Page | 1
SCHOOL OF ARCHITECTURE · BUILDING · DESIGN
Centre for Modern Architecture Studies in Southeast Asia
PROJECT MANAGEMENT [QSB 4424 / MGT 60704]
GROUP PROJECT (30%)
VOON SZE LUN (0315032)
JAKE SIA CHYI SERN (0314396)
MELVIN LIM WEI JIEN (0315772)
NORBERT VOO HSIEN YUNG (0303748)
MUHAMMAD MUZAFFAR ALLY POOMUN (0310902)
KELLYANN HIEW YAU MEI (0319532)
Lecturer: Mr. Leong Boon Tik
Submission date: 10am, 3rd July 2017
Page | 2
Table of Contents
Page
1.0 Project Background.................................................................................................................................3
2.0 Project Justification.................................................................................................................................4
2.1 Economical perspective ......................................................................................................................8
2.2 Social perspective ...............................................................................................................................9
2.3 Political perspective............................................................................................................................9
3.0 Project Objectives.................................................................................................................................10
4.0 Project Merits/Benefits.........................................................................................................................11

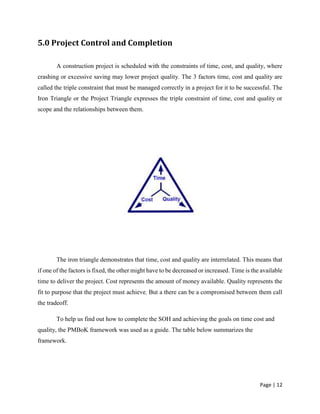

5.0 Project Control and Completion ...........................................................................................................12
6.0 Work Breakdown Structure ..................................................................................................................16
7.0 Project Cost Estimation.........................................................................................................................20
7.1 Data used for estimating project cost...............................................................................................20
7.2 Gross Development Cost ..................................................................................................................21
7.3 Operation and Maintenance Cost.....................................................................................................22
8.0 Projected Earnings ................................................................................................................................24
8.1 Season Parking..................................................................................................................................25
8.2 Food Retails.......................................................................................................................................26
8.3 Lecture Theaters ...............................................................................................................................27
8.4 X-Space Classrooms ..........................................................................................................................28
8.4 Summary of Project Earnings............................................................................................................29
8.5 Net Present Value (NPV)...................................................................................................................30
8.6 Viability of project.............................................................................................................................31
8.7 Net Profit over the 20 years..............................................................................................................31
9.0 Project Summary/ Conclusion...............................................................................................................31
10.0 References ..........................................................................................................................................32
Page | 3

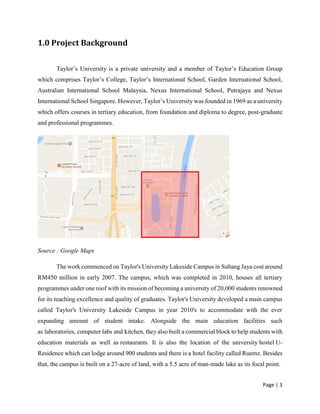

1.0 Project Background
Taylor’s University is a private university and a member of Taylor’s Education Group
which comprises Taylor’s College, Taylor’s International School, Garden International School,
Australian International School Malaysia, Nexus International School, Putrajaya and Nexus
International School Singapore. However, Taylor’s University was founded in 1969 as a university
which offers courses in tertiary education, from foundation and diploma to degree, post-graduate
and professional programmes.
Source : Google Maps
The work commenced on Taylor's University Lakeside Campus in Subang Jaya cost around
RM450 million in early 2007. The campus, which was completed in 2010, houses all tertiary
programmes under one roof with its mission of becoming a university of 20,000 students renowned
for its teaching excellence and quality of graduates. Taylor's University developed a main campus
called Taylor's University Lakeside Campus in year 2010's to accommodate with the ever
expanding amount of student intake. Alongside the main education facilities such
as laboratories, computer labs and kitchen, they also built a commercial block to help students with
education materials as well as restaurants. It is also the location of the university hostel U-
Residence which can lodge around 900 students and there is a hotel facility called Ruemz. Besides
that, the campus is built on a 27-acre of land, with a 5.5 acre of man-made lake as its focal point.
Page | 4
Other than that, Taylor’s University also provide the students with modern and up-to-date
facilities in the campus which comprises of 3 academic blocks, 22 lecture theatres, 2 blocks of
administration centre and one Grand Hall. Thus, it also included with a residential cum commercial
block and also sports centre like futsal court, tennis court and basketball court.
Nevertheless, due to its rising number of students that the Taylor’s College are moving to
Taylor’s University and the current lecture theater may unable to cater to the demand. Hence,
Taylor’s University has decided to build an extra building to meet the increasing demand.
Taylor’s has decided to rent out a plot of land adjacent to the campus. The size of the land
rented is 1200 m2. The land will be rented out to a developer which will cost RM 15,000.00 a
month for the entire 20 years. Thus, once the developer has build and run a development for a total
of 20 years then they will return to Taylor’s University at the end of their 20 years’ tenure at no
cost.
2.0 Project Justification
It is not easy developing a new business. There are many factors to be considered from the
initial idea and is a complex. A project must first be economically, socially, and politically viable
before the signing of any outlay of money. Risks should be taken into consideration and
outweighed by the advantages of the investment. Therefore, understanding the reasons and validity
of the project is important to ensure the objectives of said project are met. Project justification also
aids the investor to decide whether or not the project will render an ideal return upon completion
and operation. It will be further discussed below about the project justification in terms of
economic, social and political aspect of the project.
Page | 5

Land Area = 1200 m2
Existing Lecture Theaters Dimension (Approx.) : 15.0m long x 10.0m wide
Existing X-space (Approx.) : 10.0m long x 12.0m wide
Existing Food Retail Shop Dimension (Approx.) : 120 m2
Minimum Parking lot size: 4.80m long x 2.40m wide
(1) Lower Ground Floor 1 (LG1) and Lower Ground Floor 2 (LG2)
Assume Circulation area is about 70%,
Circulation Area = 70% x 1200m2 = 840m2 (Multiply by 2)
Area of 1 parking lot = 4.80m x 2.40m = 11.52m2
No. of parking lots in LG1 = 840m2/11.52m2 = 72
No. of parking lots in LG2 = 840m2/11.52m2 = 72
Total No. of parking lots = 72 + 72 = 144
(2) Ground Floor (Food retail shops)
Assume usable area is about 60%,
Usable Area = 60% x 1200m2 = 720m2
Page | 6

Area of 1 food retail shop = 120m2
No. of food retail shops= 720m2/120m2 = 6 units
(3) 1st,2nd, and 3rd Floors (Lecture Theaters)
Assume usable area is about 65%,
Usable area = 65% x 1200m2 = 780m2 (for each floor)
Area of 1 typical lecture theaters = 15m x 10m = 150m2
No. of LTs on each floor = 780m2/150m2 = 5
(4) 4th floor (X-space)
Assume usable area is about 75%
Usable area = 75% x 1200m2 = 900m2
Area of 1 typical x-space classroom = 10m x 12m = 120m2
No. of X-space = 900m2/120m2 = 7
Page | 7

Floors Usable Areas Circulation Areas Remaining Areas Total Area
Lower Ground
Floor 2 (Car park)
840 m2 (70%) 360 m2 1200 m2
Lower Ground
Floor 1 (Car park)
840 m2 (70%) 360 m2 1200 m2
Ground Floor
(Food retail shops
720 m2 (60%) 480 m2 1200 m2
1st
Floor (Lecture
Theaters)
780 m2 (65%) 420 m2 1200 m2
2nd
Floor (Lecture
Theaters)
780 m2 (65%) 420 m2 1200 m2
3rd
Floor (Lecture
Theaters)
780 m2 (65%) 420 m2 1200 m2
4th
Floor (X-space) 900 m2 (75%) 300 m2 1200 m2
NOTE: The remaining area is to be devoted to ancillaries such as toilets and circulation spaces such
as corridors, stairs and lift respective live.
Page | 8

2.1 Economical perspective
As in many project undertakings, the main objective is to obtain financial profit upon its
operation. As mentioned prior, the client will obtain a land from Taylor’s University for 20 years
on a monthly rental of RM15,000. It means that the developer will have to generate its income
through the operation of the multipurpose facility block upon completion of construction during
the 20-year lease.
As observed over the years, the number of students at Taylor’s University has increased
exponentially leading to scarcity of lecture theatres. Lecture theatres are generally easy to construct
as it follows the same design throughout the campus thus saving on design cost. Consequently,
the client will be able to rent the lecture theatres during the 20-year lease. Significant amounts of
revenue will be generated for the developer as he can recover the cost incurred as well as make a
profit.
Apart from that, more X-space classrooms will be constructed along with the additional
lecture theatres. Similarly, X-space classrooms do not vary much in design and can save on design
cost as well. Seeing as how there can be a lack of classrooms at Taylor’s University, the demand
for more work space is bound to be high. The developer can maximise profits of these X-space
classrooms in the duration of the 20-year lease.
Another component of the building will be the retail shops. As the population at Taylor’s
University continues to grow, the restaurants and eateries are getting more congested especially at
peak hours. Providing more retail shops will also expand the otherwise limited food choices of the
students and employees alike. The developer will be able to generate financial profit through the
rental of these retail shops during the 20-year lease.
The last component of the building is the basement car park. Taylor’s University, like any
other university, suffer from a lack of parking spaces. The problem has been made worse due to
the increasing number of enrolment. However, in the developer’s perspective, this is an
economical benefit as the demand for car parks are very high. Revenues from car parks will be in
the form of seasonal parking charge. The developer can maximize profits since car parks are
relatively cheap and require low maintenance.
Page | 9

2.2 Social perspective
Social Feasibility points the impacts that a proposed project may have on the social system
in the project environment. This proposed project is geared towards enhancing the environment at
Taylor’s University. By building more X-space classrooms, lecture theatres and retails the
crowding problem will not be as apparent. This will promote a calmer and spacious environment
for the benefit of the students. A project with such goals will surely be socially feasible.
The proposed basement car parks will prove beneficial to the students. With limited car
parks, students have to hunt for a parking space sometimes for hours on end during peak hours.
This in itself is a waste of time for students that rushing for assignments or studying for
examinations and do not want to be distracted. By providing the seasonal basement car park,
students now have less to worry about and will be more focused on the work at hand.
Considering the facts above, the proposed project is considered to be socially socially
reasonable as it will helps the students in obtaining higher grades, expectations and attainment,
more calm and focused minded, stronger peer relationships and more academically oriented
friends.
2.3 Political perspective
Political bodies always have an upper hand of most of the project being proposed. This
means that the goals and objectives of a particular project need to be in strict conformity with the
political goals and requirements. Since in this case it relates to a university project, all rules set by
the Malaysian Education department must be met. In order to do so a political feasibility analysis
need to be conducted to ensure that the requires goals and objectives fulfil the rules set by this
department which is a governmental body.
The Malaysia Education department have stated that the average income to high income
status will need to be fuelled more by talent particularly that of leaders and knowledge workers
rather than unskilled labour. It is therefore imperative for Malaysia to have a globally competitive
Page | 10
education system that produces globally competitive talent. Furthermore, globalization demands
that Malaysia’s talent needs to compete with the best internationally.
Taylor’s University has a core purpose of educating the youth of the world to one day take
their place as leaders in global community, surely better education will be provided which will
indirectly contribute in achieving the vision set up by the Malaysian government in the education
sector. More students will be shaped for the future in order to complement the persons in middle
income to high income status as predicted. Therefore, such project is politically feasible as it helps
in concretizing the Malaysian government political goals.

3.0 Project Objectives
Project’s outcome is determined by the project objectives whether it is mend to be intended
and direct, and to see if it affects the targeted group. Furthermore, it must lie within the scope of
the project and must be able to directly attribute the effects to the project. Mentioned below is the
list of objectives which will be achieved when constructing this multipurpose building project for
Taylor’s University:
1. To be able to help with the students regarding the issue of overcrowdings in the campus
by constructing this multipurpose building.
2. To provide Taylor’s University with more Lecture Theatres and X-Space classrooms to
cater to the students’ needs, to in addition might help with the better allocation of class
schedules hence able to avoid weekend and late night classes.
3. To resolve the well-known parking issues in Taylor’s University by providing
underground season parking to the students.
4. To provide more choices and variety of eateries with the food and beverage retail shops
on the lower floors to the students in Taylor’s University.
Page | 11
4.0 Project Merits/Benefits
The construction of this multipurpose building will trigger development in its
surrounding as financial landowners will now be interested in using their land due to its increase
in value. Furthermore, addition of commercial or residential buildings may be built in the near
future.
Besides that, the established lecture theatres and classrooms may be very helpful to
Taylor’s University as it provides opportunity to have more postgraduate degree courses.
Eventually, there will be creation of employment as more lecturers will be needed. Moreover,
non-academic staff such as computer technicians, cleaners will be required to maintain the
operation of the multipurpose building. In addition, these facilities will definitely reduce one of
the major issue, which is the overcrowdings in the campus.
The academic performance may surprisingly have a positive impact through the provision
of underground season car parks. This is due to the fact that it has been observed recently, that
students tend to waste lots of time just by finding a car park and eventually end up missing half
of the class. Correspondingly, students are discouraged easily to come to the university when
they have only one or two classes due to difficulty in finding parking.
The addition of retail food outlets will also be a help as students can have more variety to
their choice or selection when it comes to dining. It is also observed that students tend to get
bored fast with the choices, when it comes to choosing a place to eat on campus. Additionally, it
is also found that there is no vegetarian or more halal food shops in Taylor’s University, thus,
this might give the opportunity and the idea to the people that is renting the shop retail place.
Page | 12
5.0 Project Control and Completion
A construction project is scheduled with the constraints of time, cost, and quality, where
crashing or excessive saving may lower project quality. The 3 factors time, cost and quality are
called the triple constraint that must be managed correctly in a project for it to be successful. The
Iron Triangle or the Project Triangle expresses the triple constraint of time, cost and quality or
scope and the relationships between them.
The iron triangle demonstrates that time, cost and quality are interrelated. This means that
if one of the factors is fixed, the other might have to be decreased or increased. Time is the available
time to deliver the project. Cost represents the amount of money available. Quality represents the
fit to purpose that the project must achieve. But a there can be a compromised between them call
the tradeoff.
To help us find out how to complete the SOH and achieving the goals on time cost and

quality, the PMBoK framework was used as a guide. The table below summarizes the
framework.
Page | 13
Knowledge
Areas
Planning Process Executing
Process
Monitoring and
control Process
Closing
Process
Project
Integration
Management
Develop Project
Management Plan
Direct and
Manage Project
Works
1. Monitor and
control Project
work
Close Project
Phase
2. Perform
Integrated
Change Control
Project Scope
Management
1. Plan Scope
Management
1. Validate
Scope
2. Collect
Requirements
2. Control Scope
3. Define Scope
4 Create WBS
Project Time
Management
1. Plan Schedule
Management
Control Schedule
2. Define Activities
3. Sequence
activities
4. Estimate Activity
Durations
5. Develop Schedule
Project Cost
Management
1. Plan Cost Cost Cost
2. Estimate Costs
3. Determine Budget
Project Quality
Management
Plan Quality
Management
Perform Quality
Assurance
Control Quality
Project Human
Resource
Management
Plan Human
Resource
1. Acquire Project
Team
2. Develop
Project Team
3. Manage Project
Team
Project
Communication
Management
Plan
Communications
Manage
Communications
Control
Communications
Page | 14

Project Risk
Management
1. Plan Risk
Management
Control Risk
2. Identify Risks
3. Perform
Qualitative Risk
Analysis
4. Perform
Quantitative Risk
Analysis
5. Plan Risk
Responses
Project
Procurement
Management
Plan Procurement
Management
Conduct
Procurements
Control
Procurements
Close
Procurements
PMBoK Framework (Source: Fichtner, C. (2017). PMBOK Knowledge Areas for Project
Management Guide 5th Edition - Process Groups and Processes - The Complete Guide.
[online]
All the 9 knowledge areas mentioned above are very important for a project to be completed
on time. But for this assignment, only the four following knowledge areas will be discussed below
as stated in the PMBoK.
(1) Project Integration Management
This management emphasize on the development of a clear and precise project plan. For this
purpose, all aspects for the project requirements must be clearly set together with the client, as
discussed in the project justifications, project objectives and project benefits.
(2) Project Scope Management
This knowledge area includes the project scope, that is, the work that is comprised within the
project. Since scope changes are one of the top causes of project changes and grief in general, it
is very important that the boundaries of the project be well defined from the outset and monitored
rigorously. It is very easy for people to insert unauthorized work into the project when the project
appears to be big enough to absorb it, but most projects are estimated with the minimum cost.
Page | 15

This management involves
a) planning the scope
b) Defining the scope
c) Create a work breakdown structure
(3) Project Time Management
This is usually the most time consuming of the knowledge areas. During planning, the project
manager must divide the project into tasks and create both a schedule (start and finish dates for
each task) and budget for each task. During the project, earned value management determines the
project status at regular status intervals. Because most project changes involve a change to the
schedule, it must be continuously re-baselined and the project management plan updated.
This management points out the importance of time allocation for the various construction stages
in a project. There are:
a) Activity definition
b) Activity sequencing
c) Activity resource estimation
(4) Project Cost Management
Cost management is of utmost importance in the construction field. It will help in preparing
and forecasting the budget needed for the project to avoid any overspend. A correct and accurate
estimate of the cost and a budget plan can help out in reducing potential cost overrun.
Page | 16
6.0 Work Breakdown Structure
Page | 17

ID Activities Duration Start Finish
1 Feasibility 16 Tue 1/8/17 Wed 16/8/17
1.1 Conceptual design 14 Tue 1/8/17 Mon 14/8/17
1.2 Criteria development &
conceptual design reviews
2 Tue 15/8/17 Wed 16/8/17
2 Construction Preparation 30 Mon 21/8/17 Wed 20/9/17
2.1 Mobilization 21 Mon 21/8/17 Sun 10/9/17
2.1.1 Site possession 0 Mon 21/8/17 Mon 21/8/17
2.1.2 Site survey 7 Mon 21/8/17 Sun 27/8/17
2.1.3 Plant & Machinery 14 Mon 28/8/17 Mon 11/9/17
2.2 Site Preparation 9 Tue 12/9/17 Wed 20/9/17
2.2.1 Site clearing 3 Tue 12/9/17 Thu 14/9/17
2.2.2 General excavation 3 Fri 15/9/17 Sat 16/9/17
2.2.3 Grading general area 3 Sun 17/9/17 Wed 20/9/17
3 Construction 430 Mon 25/9/17
3.1 Substructure 176 Mon 25/9/17 Sun 1/4/18
3.1.1 Basement 176 Mon 25/9/17 Fri 1/4/18
3.1.1.1 Excavating for basements (B1
& B2)
78 Mon 25/9/17 Thu 14/12/17
3.1.1.2 Retaining walls 65 Mon 18/12/17 Tue 27/2/18
3.1.1.3 Damp proof course 65 Mon 18/12/17 Tue 27/2/18
3.1.1.4 Basement structures 33 Wed 28/2/18 Sun 1/4/18
3.1.1.5 Ramps 26 Wed 7/3/18 Sun 1/4/18
3.1.2 Foundation 38 Tue 2/1/18 Sun 11/2/18
3.1.2.1 Piling 38 Tue 2/1/18 Sun 11/2/18
3.2 Superstructure 254 Mon 2/4/18
3.2.1 Frame 58 Mon 2/4/18 Wed 30/5/18
3.2.1.1 Columns 48 Mon 2/4/18 Sun 20/5/18
3.2.1.2 Beams 43 Tue 17/4/18 Wed 30/5/18
3.2.2 Upper Floors 30 Sat 2/6/18 Sun 1/7/18
3.2.2.1 Floor structures 30 Sat 2/6/18 Sun 1/7/18
Page | 18
3.2.3 Roof 25 Sat 2/6/18 Tue 26/6/18
3.2.3.1 Roof structures 15 Sat 2/6/18 Sat 16/6/18
3.2.3.2 Roof covering 10 Sun 17/6/18 Tue 26/6/18
3.2.3 Vertical Transportation 30 Sat 2/6/18 Sun 1/7/18
3.2.3.1 Stairs structure 30 Sat 2/6/18 Sun 1/7/18
3.2.3.2 Lifts pit 12 Sat 2/6/18 Wed 13/6/18
3.2.4 External Walls 76 Sat 2/6/18 Sat 18/8/18
3.2.4.1 Masonry work 76 Sat 2/6/18 Sat 18/8/18
3.2.5 Internal Walls 46 Wed 27/6/18 Mon 13/8/18
3.2.5.1 Masonry work 43 Wed 27/6/18 Fri 10/8/18
3.2.5.2 Partitions 31 Fri 13/7/18 Mon 13/8/18
3.2.6 Doors and Windows 26 Mon 20/8/18 Sat 15/9/18
3.2.6.1 Door & window frame 22 Mon 20/8/18 Tue 22/9/18
3.2.6.2 Door & window leaves 17 Wed 29/8/18 Sat 15/9/18
3.3 Building Finishes 80 Tue 14/8/18 Mon 5/11/18
3.3.1 Internal wall finishes 15 Tue 14/8/18 Thu 30/8/18
3.3.2 External wall finishes 15 Mon 20/8/18 Tue 4/9/18
3.3.3 Floor finishes 20 Fri 31/8/18 Thu 20/9/18
3.3.4 Ceiling finishes 20 Fri 21/9/18 Wed 10/10/18
3.3.5 Staircase finishes 20 Fri 31/8/18 Thu 20/9/18
3.3.6 Basement finishes 25 Thu 11/10/18 Mon 5/11/18
3.4 Furnishings and Fittings 25 Tue 6/11/18 Sat 1/12/18
3.4.1 Furniture 10 Tue 6/11/18 Thu 15/11/18
3.4.2 Equipment 25 Tue 6/11/18 Sat 1/12/18
3.4.3 Sanitary wares 16 Tue 6/11/18 Thu 22/11/18
3.5 M&E Works 45 Tue 6/11/18 Fri 21/12/18
3.5.1 Plumbing 45 Tue 6/11/18 Fri 21/12/18
3.5.2 Electrical 34 Sat 17/11/18 Fri 21/12/18
3.5.3 Air-conditioning 27 Sun 25/11/18 Fri 21/12/18
3.5.4 Fire protection 29 Fri 23/11/18 Fri 21/12/18
Page | 19

3.5.5 Lift 10 Wed 12/12/18 Fri 21/12/18
3.6 Infrastructure Works 57 Tue 6/11/18 Sat 5/1/19
3.6.1 Sewerage works 57 Tue 6/11/18 Sat 5/1/19
3.6.2 Surface water drainage 55 Thu 8/11/18 Sat5/1/19
3.6.3 External reticulation works for
M&E
24 Fri 21/12/18 Thu 17/1/19
3.6.4 Road works 33 Tue 6/11/18 Thu 20/12/18
3.6.5 Road kerbs 24 Thu 20/12/18 Tue 15/1/19
3.6.6 Walkway 20 Mon 24/12/18 Tue 15/1/19
3.6.7 Underground cable services 25 Tue 6/11/18 Sat 1/12/18
3.6.8 Fencing 30 Wed 14/11/18 Fri 14/12/18
3.6.9 Landscaping 20 Thu 13/12/18 Sat 5/1/19
4 Demobilization 30 Mon 7/1/19 Fri 1/2/19
4.1 Testing and Commissioning 20 Mon 7/1/19 Sat 26/1/19
4.2 Cleaning and Clearing 10 Mon 28/1/19 Fri 1/2/19
Page | 20
7.0 Project Cost Estimation
Project underestimation of resources and costs is one of the most common contributors to
project failure. Thus, project managers should have a sound knowledge of the various construction
techniques and tools in the defining and executing the project cost estimation. As defined by the
Project Management Body of Knowledge (PMBOK), cost estimation is the iterative process of
developing an approximation of the monetary resources needed to complete project activities.
The cost that is associated with this project include both the initial capital cost and the
subsequent operation and maintenance costs. As always, the client will want to achieve the lowest
possible net project cost keeping in mind the investment cost and how to recover his money. But
the scale of these cost components will be subjected to the nature, size and location of the project
itself.
In order to accurately produce a cost estimate for this project, construction cost handbook
for like JUBM and Langdon Seah Construction has been used to obtained the relevant cost data
which are up to date. Construction cost data fit for this project are related to underground car park,
medium rise offices and retail outlets. Other costs like for example the development cost which
includes numerous cost like professional fees, legal fees, administrative fees, planning fees and
contingencies are based on percentage of the total construction cost.
7.1 Data used for estimating project cost
(1) Construction Cost (L&S cost handbook related to Kuala Lumpur)
i. Average Standard offices (Lecture Theaters) RM 2470/m2 (inclusive of services)
ii. Average Standard offices (X-space) RM 2470/m2 (inclusive of services)
iii. Food retail outlets RM 2760/m2 (inclusive of services)
iv. Basement carparks(less than 3 levels) RM 1475/m2 (inclusive of services)
Page | 21

(2) Development Cost
i. Professional Fees : 8% of construction costs
ii. Administrative Fees : 2% of construction costs
iii. Plan Fees : 2% of construction costs
iv. Legal Fees : 1% of construction costs
v. Contingencies : 5% of construction costs
7.2 Gross Development Cost
(a) Construction Cost
No Type No. of
Floors
Net
Build Up
Area
(m2)
Construction Cost
(RM/m2) from L&S
Construction
Cost
(RM/m2) for
this project
Construction
Cost (RM)
1 Basement Car
Parks 2 2400 1,475.00 1,475.00 3,540,000.00
2 Food Retail
Outlets 1 1200 2,760.00 2,760.00 3,312,000.00
3 Lecture
Theaters 3 3600
2,470.00 (subjected
to 10%) 2,717.00 9,781,200.00
4 X-space
classroom 1 1200
2,470.00 (subjected
to 10%) 2,717.00 3,260,400.00
NET TOTAL
7 8400 19,893,600.00
Assumption: Increase the price for the lecture theaters and the X-space classroom by 10% due to
the special furniture and digital accessories.
Assumption: The cost data include circulation spaces and ancillary services like toilets, staircases,
lifts and walkways.
Page | 22

(b) Development Cost
No. % Allocation
Construction Cost
(RM)
Development Cost
(RM)
1 Professional Fees 8%
19,893,600.00
1,591,488.00
2
Administrative
Fees 2% 397,872.00
3 Plan Fees 2% 397,872.00
4 Legal Fees 1% 198,936.00
5 Contingencies 5% 994,680.00
NET TOTAL 3,580,848.00
Gross Development Cost (GDC) = Construction cost + Development Cost
= RM 19,893,600.00 + RM 3,580,848.00
= RM 23,474,448.00
7.3 Operation and Maintenance Cost
A building like this project which is dedicated to the students of the Taylor’s University
would carry a consequent cost for operating and maintaining the whole building . Since the
client will rent the land for RM 15,000 per month for a period of 20 years and that he will do the
whole development under his expense, it is assumed that the client should bear the whole operation
and maintenance cost without any help from Taylor’s University. But without proper
communication with the management of university, the client will not be able to accurately
estimate the monthly operation and maintenance cost. It is imperative that the client liaise with the
university. Also, to cater for any inflation in prices, it is assumed that the monthly expenses should
be subjected to a 5% increase every 5 years. The monthly expenses obtained for 1 block are as
follows:

Page | 23
Electricity and water : RM 100,000
Repairing cost : RM 20,000
Cleaning cost : RM 20,000
Now these costs are for one block which contains operating and maintaining costs for 11
fully operated floors. Using the prices above, the expenses for the new academic block are
calculated accordingly and it will also include the monthly rental for the land bearing in mind that
there will not be any cleaning cost and repairing cost at it is the construction period.
Monthly expenses
for new building
Electricity and
water 60,000.00
Repairing cost 10,000.00
Cleaning cost 10,000.00
Land Rental 15,000.00
NET TOTAL 95,000.00
%
increase
Monthly
Expenses for
new building
(RM)
Yearly
Expenses
(RM) TOTAL
Expenses (RM)
Year 1 (12months) 15,000.00 180,000.00 180,000.00
Year 2 to 5 (48 months) 95,000.00 1,140,000.00 4,560,000
Year 6 to 10 (60 months) 5% 99,750.00 1,197,000.00 5,985,000.00
Year 11 to 15 (60 months) 5% 104,737.50 1,256,850.00 6,284,250.00
Year 15 to 20 (60 months) 5% 109,974.38 1,319,704.50 6,598,462.50
NET TOTAL 23,607,712.50
Page | 24

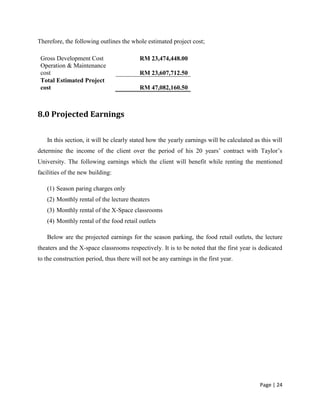

Therefore, the following outlines the whole estimated project cost;
Gross Development Cost RM 23,474,448.00
Operation & Maintenance
cost RM 23,607,712.50
Total Estimated Project
cost RM 47,082,160.50
8.0 Projected Earnings
In this section, it will be clearly stated how the yearly earnings will be calculated as this will
determine the income of the client over the period of his 20 years’ contract with Taylor’s
University. The following earnings which the client will benefit while renting the mentioned
facilities of the new building:
(1) Season paring charges only
(2) Monthly rental of the lecture theaters
(3) Monthly rental of the X-Space classrooms
(4) Monthly rental of the food retail outlets
Below are the projected earnings for the season parking, the food retail outlets, the lecture
theaters and the X-space classrooms respectively. It is to be noted that the first year is dedicated
to the construction period, thus there will not be any earnings in the first year.
Page | 25

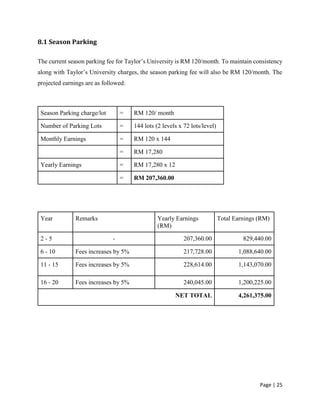

8.1 Season Parking
The current season parking fee for Taylor’s University is RM 120/month. To maintain consistency
along with Taylor’s University charges, the season parking fee will also be RM 120/month. The
projected earnings are as followed:
Season Parking charge/lot = RM 120/ month
Number of Parking Lots = 144 lots (2 levels x 72 lots/level)
Monthly Earnings = RM 120 x 144
= RM 17,280
Yearly Earnings = RM 17,280 x 12
= RM 207,360.00
Year Remarks Yearly Earnings
(RM)
Total Earnings (RM)
2 - 5 - 207,360.00 829,440.00
6 - 10 Fees increases by 5% 217,728.00 1,088,640.00
11 - 15 Fees increases by 5% 228,614.00 1,143,070.00
16 - 20 Fees increases by 5% 240,045.00 1,200,225.00
NET TOTAL 4,261,375.00
Page | 26

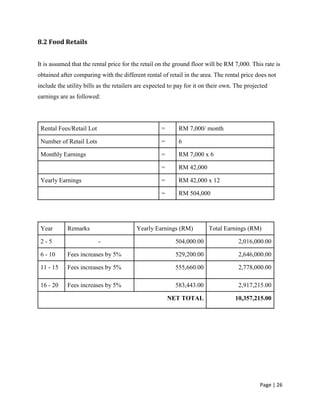

8.2 Food Retails
It is assumed that the rental price for the retail on the ground floor will be RM 7,000. This rate is
obtained after comparing with the different rental of retail in the area. The rental price does not
include the utility bills as the retailers are expected to pay for it on their own. The projected
earnings are as followed:
Rental Fees/Retail Lot = RM 7,000/ month
Number of Retail Lots = 6
Monthly Earnings = RM 7,000 x 6
= RM 42,000
Yearly Earnings = RM 42,000 x 12
= RM 504,000
Year Remarks Yearly Earnings (RM) Total Earnings (RM)
2 - 5 - 504,000.00 2,016,000.00
6 - 10 Fees increases by 5% 529,200.00 2,646,000.00
11 - 15 Fees increases by 5% 555,660.00 2,778,000.00
16 - 20 Fees increases by 5% 583,443.00 2,917,215.00
NET TOTAL 10,357,215.00
Page | 27

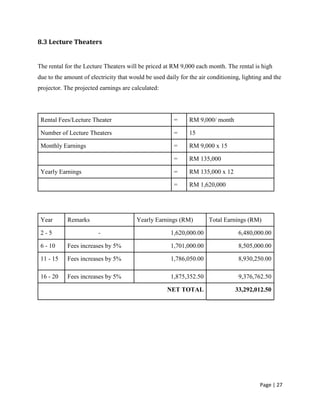

8.3 Lecture Theaters
The rental for the Lecture Theaters will be priced at RM 9,000 each month. The rental is high
due to the amount of electricity that would be used daily for the air conditioning, lighting and the
projector. The projected earnings are calculated:
Rental Fees/Lecture Theater = RM 9,000/ month
Number of Lecture Theaters = 15
Monthly Earnings = RM 9,000 x 15
= RM 135,000
Yearly Earnings = RM 135,000 x 12
= RM 1,620,000
Year Remarks Yearly Earnings (RM) Total Earnings (RM)
2 - 5 - 1,620,000.00 6,480,000.00
6 - 10 Fees increases by 5% 1,701,000.00 8,505,000.00
11 - 15 Fees increases by 5% 1,786,050.00 8,930,250.00
16 - 20 Fees increases by 5% 1,875,352.50 9,376,762.50
NET TOTAL 33,292,012.50
Page | 28
8.4 X-Space Classrooms
The rental for the X-Space classrooms will be priced at RM 9,000 each month. The rental is high
due to the amount of electricity that would be used daily for the air conditioning, lighting and the
projector. The projected earnings are as followed:
Rental Fees/Lecture Theater = RM 9,000/ month
Number of Lecture Theaters = 7
Monthly Earnings = RM 9,000 x 7
= RM 63,000
Yearly Earnings = RM 63,000 x 12
= RM 756,000
Year Remarks Yearly Earnings (RM) Total Earnings (RM)
2 - 5 - 756,000.00 3,024,000.00
6 - 10 Fees increases by 5% 793,800.00 3,969,000.00
11 - 15 Fees increases by 5% 833,490.00 4,167,450.00
16 - 20 Fees increases by 5% 875,164.50 4,375,822.50
NET TOTAL 15,536,272.50
Page | 29

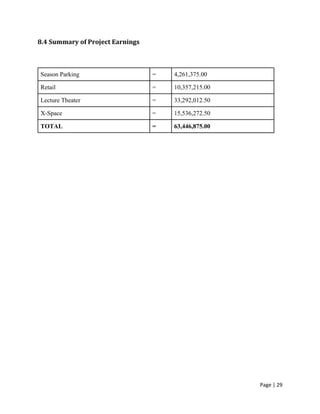

8.4 Summary of Project Earnings
Season Parking = 4,261,375.00
Retail = 10,357,215.00
Lecture Theater = 33,292,012.50
X-Space = 15,536,272.50
TOTAL = 63,446,875.00
Page | 30

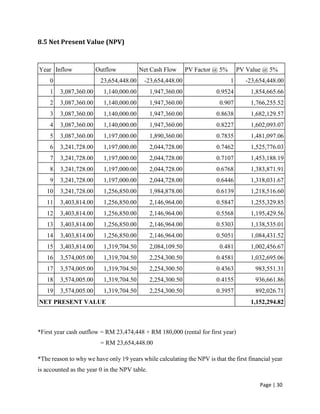

8.5 Net Present Value (NPV)
Year Inflow Outflow Net Cash Flow PV Factor @ 5% PV Value @ 5%
0 23,654,448.00 -23,654,448.00 1 -23,654,448.00
1 3,087,360.00 1,140,000.00 1,947,360.00 0.9524 1,854,665.66
2 3,087,360.00 1,140,000.00 1,947,360.00 0.907 1,766,255.52
3 3,087,360.00 1,140,000.00 1,947,360.00 0.8638 1,682,129.57
4 3,087,360.00 1,140,000.00 1,947,360.00 0.8227 1,602,093.07
5 3,087,360.00 1,197,000.00 1,890,360.00 0.7835 1,481,097.06
6 3,241,728.00 1,197,000.00 2,044,728.00 0.7462 1,525,776.03
7 3,241,728.00 1,197,000.00 2,044,728.00 0.7107 1,453,188.19
8 3,241,728.00 1,197,000.00 2,044,728.00 0.6768 1,383,871.91
9 3,241,728.00 1,197,000.00 2,044,728.00 0.6446 1,318,031.67
10 3,241,728.00 1,256,850.00 1,984,878.00 0.6139 1,218,516.60
11 3,403,814.00 1,256,850.00 2,146,964.00 0.5847 1,255,329.85
12 3,403,814.00 1,256,850.00 2,146,964.00 0.5568 1,195,429.56
13 3,403,814.00 1,256,850.00 2,146,964.00 0.5303 1,138,535.01
14 3,403,814.00 1,256,850.00 2,146,964.00 0.5051 1,084,431.52
15 3,403,814.00 1,319,704.50 2,084,109.50 0.481 1,002,456.67
16 3,574,005.00 1,319,704.50 2,254,300.50 0.4581 1,032,695.06
17 3,574,005.00 1,319,704.50 2,254,300.50 0.4363 983,551.31
18 3,574,005.00 1,319,704.50 2,254,300.50 0.4155 936,661.86
19 3,574,005.00 1,319,704.50 2,254,300.50 0.3957 892,026.71
NET PRESENT VALUE 1,152,294.82
*First year cash outflow = RM 23,474,448 + RM 180,000 (rental for first year)
= RM 23,654,448.00
*The reason to why we have only 19 years while calculating the NPV is that the first financial year
is accounted as the year 0 in the NPV table.
Page | 31
8.6 Viability of project
The reason why the NPV was calculated is to find whether this project will benefit the client or
not. By having a positive NPV at a PV factor of 5%, Its shows that this project is acceptable and
can proceed with the development.
8.7 Net Profit over the 20 years
Estimated project earnings for 20 years RM 63,446,875.00
Invested GDC -RM 23,474,448.00
Operation and maintenance cost for 20 years -RM 23,607,712.50
NET PROFIT RM 16,364,714.50
9.0 Project Summary/ Conclusion
As a summary, the proposed project is an additional block which comprises of 7 floors with 2
levels of basement parking spaces, 1 floor of food retail outlets which located on ground floor, 3
floors of lecture theater units and X-space units that located on 4th
floor. This project is to make
sure that it can help Taylor’s University in solving the issues such as insufficient parking spaces,
retails and lecture units. Besides that, it also will ease the ascension of Taylor’s University to the
most preferred university in Malaysia.
For the estimation part, it proved extremely profitable to the client as the estimation above
shows that within 20 years of the additional block, the client will be able to make a profit of RM
16,364,714.50. Besides that, this will facilitate the client in term of finances on funding other
projects which can lead him to a higher level of success. The students in Taylor’s University can
also have a chance to live and study in a better environment through the access of such facilities.
Page | 32
10.0 References
Anon, (2017). [online] Available at: http://http//doit.maryland.gov/sdlc/documents/cost
estimating.pdf
Anon, (2017). [online] Available at: https://www.projectsmart.co.uk/project-management-scope-
triangle.php
Anon, (2017). [online] Available at: http://www.langdonseah.com/en/sg/files/download/3796
Iproperty.com.my. (2017). Cite a Website - Cite This For Me. [online] Available at:
https://www.iproperty.com.my/propertynearby/16879/S/Sunway_Pyramid_ForRent
Fichtner, C. (2017). PMBOK Knowledge Areas for Project Management Guide 5th Edition -
Process Groups and Processes - The Complete Guide. [online] Project-management-
prepcast.com. Available at: https://www.project-management-prepcast.com/pmbok-knowledge-
areas-and-pmi-process-groups
Hartney, J. (2017). The 10 PMBOK Knowledge Areas. [online] ProjectEngineer. Available at:
http://www.projectengineer.net/the-10-pmbok-knowledge-areas/
Padu.edu.my. (2017). PADU | MEB. [online] Available at: http://www.padu.edu.my/meb
Pmbook.ce.cmu.edu. (2017). Project Management for Construction: Cost Estimation. [online]
Available at: http://pmbook.ce.cmu.edu/05_Cost_Estimation.html
Costengineering.eu. (2017). Which are the best techniques for project cost estimating?. [online]
Available at: http://www.costengineering.eu/blog-article/which-are-the-best-techniques-for-
project-cost-estimating

PM Final Assignment Report

  • 1.
    Page | 1 SCHOOLOF ARCHITECTURE · BUILDING · DESIGN Centre for Modern Architecture Studies in Southeast Asia PROJECT MANAGEMENT [QSB 4424 / MGT 60704] GROUP PROJECT (30%) VOON SZE LUN (0315032) JAKE SIA CHYI SERN (0314396) MELVIN LIM WEI JIEN (0315772) NORBERT VOO HSIEN YUNG (0303748) MUHAMMAD MUZAFFAR ALLY POOMUN (0310902) KELLYANN HIEW YAU MEI (0319532) Lecturer: Mr. Leong Boon Tik Submission date: 10am, 3rd July 2017
  • 2.
    Page | 2 Tableof Contents Page 1.0 Project Background.................................................................................................................................3 2.0 Project Justification.................................................................................................................................4 2.1 Economical perspective ......................................................................................................................8 2.2 Social perspective ...............................................................................................................................9 2.3 Political perspective............................................................................................................................9 3.0 Project Objectives.................................................................................................................................10 4.0 Project Merits/Benefits.........................................................................................................................11 5.0 Project Control and Completion ...........................................................................................................12 6.0 Work Breakdown Structure ..................................................................................................................16 7.0 Project Cost Estimation.........................................................................................................................20 7.1 Data used for estimating project cost...............................................................................................20 7.2 Gross Development Cost ..................................................................................................................21 7.3 Operation and Maintenance Cost.....................................................................................................22 8.0 Projected Earnings ................................................................................................................................24 8.1 Season Parking..................................................................................................................................25 8.2 Food Retails.......................................................................................................................................26 8.3 Lecture Theaters ...............................................................................................................................27 8.4 X-Space Classrooms ..........................................................................................................................28 8.4 Summary of Project Earnings............................................................................................................29 8.5 Net Present Value (NPV)...................................................................................................................30 8.6 Viability of project.............................................................................................................................31 8.7 Net Profit over the 20 years..............................................................................................................31 9.0 Project Summary/ Conclusion...............................................................................................................31 10.0 References ..........................................................................................................................................32
  • 3.
    Page | 3 1.0Project Background Taylor’s University is a private university and a member of Taylor’s Education Group which comprises Taylor’s College, Taylor’s International School, Garden International School, Australian International School Malaysia, Nexus International School, Putrajaya and Nexus International School Singapore. However, Taylor’s University was founded in 1969 as a university which offers courses in tertiary education, from foundation and diploma to degree, post-graduate and professional programmes. Source : Google Maps The work commenced on Taylor's University Lakeside Campus in Subang Jaya cost around RM450 million in early 2007. The campus, which was completed in 2010, houses all tertiary programmes under one roof with its mission of becoming a university of 20,000 students renowned for its teaching excellence and quality of graduates. Taylor's University developed a main campus called Taylor's University Lakeside Campus in year 2010's to accommodate with the ever expanding amount of student intake. Alongside the main education facilities such as laboratories, computer labs and kitchen, they also built a commercial block to help students with education materials as well as restaurants. It is also the location of the university hostel U- Residence which can lodge around 900 students and there is a hotel facility called Ruemz. Besides that, the campus is built on a 27-acre of land, with a 5.5 acre of man-made lake as its focal point.
  • 4.
    Page | 4 Otherthan that, Taylor’s University also provide the students with modern and up-to-date facilities in the campus which comprises of 3 academic blocks, 22 lecture theatres, 2 blocks of administration centre and one Grand Hall. Thus, it also included with a residential cum commercial block and also sports centre like futsal court, tennis court and basketball court. Nevertheless, due to its rising number of students that the Taylor’s College are moving to Taylor’s University and the current lecture theater may unable to cater to the demand. Hence, Taylor’s University has decided to build an extra building to meet the increasing demand. Taylor’s has decided to rent out a plot of land adjacent to the campus. The size of the land rented is 1200 m2. The land will be rented out to a developer which will cost RM 15,000.00 a month for the entire 20 years. Thus, once the developer has build and run a development for a total of 20 years then they will return to Taylor’s University at the end of their 20 years’ tenure at no cost. 2.0 Project Justification It is not easy developing a new business. There are many factors to be considered from the initial idea and is a complex. A project must first be economically, socially, and politically viable before the signing of any outlay of money. Risks should be taken into consideration and outweighed by the advantages of the investment. Therefore, understanding the reasons and validity of the project is important to ensure the objectives of said project are met. Project justification also aids the investor to decide whether or not the project will render an ideal return upon completion and operation. It will be further discussed below about the project justification in terms of economic, social and political aspect of the project.
  • 5.
    Page | 5 LandArea = 1200 m2 Existing Lecture Theaters Dimension (Approx.) : 15.0m long x 10.0m wide Existing X-space (Approx.) : 10.0m long x 12.0m wide Existing Food Retail Shop Dimension (Approx.) : 120 m2 Minimum Parking lot size: 4.80m long x 2.40m wide (1) Lower Ground Floor 1 (LG1) and Lower Ground Floor 2 (LG2) Assume Circulation area is about 70%, Circulation Area = 70% x 1200m2 = 840m2 (Multiply by 2) Area of 1 parking lot = 4.80m x 2.40m = 11.52m2 No. of parking lots in LG1 = 840m2/11.52m2 = 72 No. of parking lots in LG2 = 840m2/11.52m2 = 72 Total No. of parking lots = 72 + 72 = 144 (2) Ground Floor (Food retail shops) Assume usable area is about 60%, Usable Area = 60% x 1200m2 = 720m2
  • 6.
    Page | 6 Areaof 1 food retail shop = 120m2 No. of food retail shops= 720m2/120m2 = 6 units (3) 1st,2nd, and 3rd Floors (Lecture Theaters) Assume usable area is about 65%, Usable area = 65% x 1200m2 = 780m2 (for each floor) Area of 1 typical lecture theaters = 15m x 10m = 150m2 No. of LTs on each floor = 780m2/150m2 = 5 (4) 4th floor (X-space) Assume usable area is about 75% Usable area = 75% x 1200m2 = 900m2 Area of 1 typical x-space classroom = 10m x 12m = 120m2 No. of X-space = 900m2/120m2 = 7
  • 7.
    Page | 7 FloorsUsable Areas Circulation Areas Remaining Areas Total Area Lower Ground Floor 2 (Car park) 840 m2 (70%) 360 m2 1200 m2 Lower Ground Floor 1 (Car park) 840 m2 (70%) 360 m2 1200 m2 Ground Floor (Food retail shops 720 m2 (60%) 480 m2 1200 m2 1st Floor (Lecture Theaters) 780 m2 (65%) 420 m2 1200 m2 2nd Floor (Lecture Theaters) 780 m2 (65%) 420 m2 1200 m2 3rd Floor (Lecture Theaters) 780 m2 (65%) 420 m2 1200 m2 4th Floor (X-space) 900 m2 (75%) 300 m2 1200 m2 NOTE: The remaining area is to be devoted to ancillaries such as toilets and circulation spaces such as corridors, stairs and lift respective live.
  • 8.
    Page | 8 2.1Economical perspective As in many project undertakings, the main objective is to obtain financial profit upon its operation. As mentioned prior, the client will obtain a land from Taylor’s University for 20 years on a monthly rental of RM15,000. It means that the developer will have to generate its income through the operation of the multipurpose facility block upon completion of construction during the 20-year lease. As observed over the years, the number of students at Taylor’s University has increased exponentially leading to scarcity of lecture theatres. Lecture theatres are generally easy to construct as it follows the same design throughout the campus thus saving on design cost. Consequently, the client will be able to rent the lecture theatres during the 20-year lease. Significant amounts of revenue will be generated for the developer as he can recover the cost incurred as well as make a profit. Apart from that, more X-space classrooms will be constructed along with the additional lecture theatres. Similarly, X-space classrooms do not vary much in design and can save on design cost as well. Seeing as how there can be a lack of classrooms at Taylor’s University, the demand for more work space is bound to be high. The developer can maximise profits of these X-space classrooms in the duration of the 20-year lease. Another component of the building will be the retail shops. As the population at Taylor’s University continues to grow, the restaurants and eateries are getting more congested especially at peak hours. Providing more retail shops will also expand the otherwise limited food choices of the students and employees alike. The developer will be able to generate financial profit through the rental of these retail shops during the 20-year lease. The last component of the building is the basement car park. Taylor’s University, like any other university, suffer from a lack of parking spaces. The problem has been made worse due to the increasing number of enrolment. However, in the developer’s perspective, this is an economical benefit as the demand for car parks are very high. Revenues from car parks will be in the form of seasonal parking charge. The developer can maximize profits since car parks are relatively cheap and require low maintenance.
  • 9.
    Page | 9 2.2Social perspective Social Feasibility points the impacts that a proposed project may have on the social system in the project environment. This proposed project is geared towards enhancing the environment at Taylor’s University. By building more X-space classrooms, lecture theatres and retails the crowding problem will not be as apparent. This will promote a calmer and spacious environment for the benefit of the students. A project with such goals will surely be socially feasible. The proposed basement car parks will prove beneficial to the students. With limited car parks, students have to hunt for a parking space sometimes for hours on end during peak hours. This in itself is a waste of time for students that rushing for assignments or studying for examinations and do not want to be distracted. By providing the seasonal basement car park, students now have less to worry about and will be more focused on the work at hand. Considering the facts above, the proposed project is considered to be socially socially reasonable as it will helps the students in obtaining higher grades, expectations and attainment, more calm and focused minded, stronger peer relationships and more academically oriented friends. 2.3 Political perspective Political bodies always have an upper hand of most of the project being proposed. This means that the goals and objectives of a particular project need to be in strict conformity with the political goals and requirements. Since in this case it relates to a university project, all rules set by the Malaysian Education department must be met. In order to do so a political feasibility analysis need to be conducted to ensure that the requires goals and objectives fulfil the rules set by this department which is a governmental body. The Malaysia Education department have stated that the average income to high income status will need to be fuelled more by talent particularly that of leaders and knowledge workers rather than unskilled labour. It is therefore imperative for Malaysia to have a globally competitive
  • 10.
    Page | 10 educationsystem that produces globally competitive talent. Furthermore, globalization demands that Malaysia’s talent needs to compete with the best internationally. Taylor’s University has a core purpose of educating the youth of the world to one day take their place as leaders in global community, surely better education will be provided which will indirectly contribute in achieving the vision set up by the Malaysian government in the education sector. More students will be shaped for the future in order to complement the persons in middle income to high income status as predicted. Therefore, such project is politically feasible as it helps in concretizing the Malaysian government political goals. 3.0 Project Objectives Project’s outcome is determined by the project objectives whether it is mend to be intended and direct, and to see if it affects the targeted group. Furthermore, it must lie within the scope of the project and must be able to directly attribute the effects to the project. Mentioned below is the list of objectives which will be achieved when constructing this multipurpose building project for Taylor’s University: 1. To be able to help with the students regarding the issue of overcrowdings in the campus by constructing this multipurpose building. 2. To provide Taylor’s University with more Lecture Theatres and X-Space classrooms to cater to the students’ needs, to in addition might help with the better allocation of class schedules hence able to avoid weekend and late night classes. 3. To resolve the well-known parking issues in Taylor’s University by providing underground season parking to the students. 4. To provide more choices and variety of eateries with the food and beverage retail shops on the lower floors to the students in Taylor’s University.
  • 11.
    Page | 11 4.0Project Merits/Benefits The construction of this multipurpose building will trigger development in its surrounding as financial landowners will now be interested in using their land due to its increase in value. Furthermore, addition of commercial or residential buildings may be built in the near future. Besides that, the established lecture theatres and classrooms may be very helpful to Taylor’s University as it provides opportunity to have more postgraduate degree courses. Eventually, there will be creation of employment as more lecturers will be needed. Moreover, non-academic staff such as computer technicians, cleaners will be required to maintain the operation of the multipurpose building. In addition, these facilities will definitely reduce one of the major issue, which is the overcrowdings in the campus. The academic performance may surprisingly have a positive impact through the provision of underground season car parks. This is due to the fact that it has been observed recently, that students tend to waste lots of time just by finding a car park and eventually end up missing half of the class. Correspondingly, students are discouraged easily to come to the university when they have only one or two classes due to difficulty in finding parking. The addition of retail food outlets will also be a help as students can have more variety to their choice or selection when it comes to dining. It is also observed that students tend to get bored fast with the choices, when it comes to choosing a place to eat on campus. Additionally, it is also found that there is no vegetarian or more halal food shops in Taylor’s University, thus, this might give the opportunity and the idea to the people that is renting the shop retail place.
  • 12.
    Page | 12 5.0Project Control and Completion A construction project is scheduled with the constraints of time, cost, and quality, where crashing or excessive saving may lower project quality. The 3 factors time, cost and quality are called the triple constraint that must be managed correctly in a project for it to be successful. The Iron Triangle or the Project Triangle expresses the triple constraint of time, cost and quality or scope and the relationships between them. The iron triangle demonstrates that time, cost and quality are interrelated. This means that if one of the factors is fixed, the other might have to be decreased or increased. Time is the available time to deliver the project. Cost represents the amount of money available. Quality represents the fit to purpose that the project must achieve. But a there can be a compromised between them call the tradeoff. To help us find out how to complete the SOH and achieving the goals on time cost and quality, the PMBoK framework was used as a guide. The table below summarizes the framework.
  • 13.
    Page | 13 Knowledge Areas PlanningProcess Executing Process Monitoring and control Process Closing Process Project Integration Management Develop Project Management Plan Direct and Manage Project Works 1. Monitor and control Project work Close Project Phase 2. Perform Integrated Change Control Project Scope Management 1. Plan Scope Management 1. Validate Scope 2. Collect Requirements 2. Control Scope 3. Define Scope 4 Create WBS Project Time Management 1. Plan Schedule Management Control Schedule 2. Define Activities 3. Sequence activities 4. Estimate Activity Durations 5. Develop Schedule Project Cost Management 1. Plan Cost Cost Cost 2. Estimate Costs 3. Determine Budget Project Quality Management Plan Quality Management Perform Quality Assurance Control Quality Project Human Resource Management Plan Human Resource 1. Acquire Project Team 2. Develop Project Team 3. Manage Project Team Project Communication Management Plan Communications Manage Communications Control Communications
  • 14.
    Page | 14 ProjectRisk Management 1. Plan Risk Management Control Risk 2. Identify Risks 3. Perform Qualitative Risk Analysis 4. Perform Quantitative Risk Analysis 5. Plan Risk Responses Project Procurement Management Plan Procurement Management Conduct Procurements Control Procurements Close Procurements PMBoK Framework (Source: Fichtner, C. (2017). PMBOK Knowledge Areas for Project Management Guide 5th Edition - Process Groups and Processes - The Complete Guide. [online] All the 9 knowledge areas mentioned above are very important for a project to be completed on time. But for this assignment, only the four following knowledge areas will be discussed below as stated in the PMBoK. (1) Project Integration Management This management emphasize on the development of a clear and precise project plan. For this purpose, all aspects for the project requirements must be clearly set together with the client, as discussed in the project justifications, project objectives and project benefits. (2) Project Scope Management This knowledge area includes the project scope, that is, the work that is comprised within the project. Since scope changes are one of the top causes of project changes and grief in general, it is very important that the boundaries of the project be well defined from the outset and monitored rigorously. It is very easy for people to insert unauthorized work into the project when the project appears to be big enough to absorb it, but most projects are estimated with the minimum cost.
  • 15.
    Page | 15 Thismanagement involves a) planning the scope b) Defining the scope c) Create a work breakdown structure (3) Project Time Management This is usually the most time consuming of the knowledge areas. During planning, the project manager must divide the project into tasks and create both a schedule (start and finish dates for each task) and budget for each task. During the project, earned value management determines the project status at regular status intervals. Because most project changes involve a change to the schedule, it must be continuously re-baselined and the project management plan updated. This management points out the importance of time allocation for the various construction stages in a project. There are: a) Activity definition b) Activity sequencing c) Activity resource estimation (4) Project Cost Management Cost management is of utmost importance in the construction field. It will help in preparing and forecasting the budget needed for the project to avoid any overspend. A correct and accurate estimate of the cost and a budget plan can help out in reducing potential cost overrun.
  • 16.
    Page | 16 6.0Work Breakdown Structure
  • 17.
    Page | 17 IDActivities Duration Start Finish 1 Feasibility 16 Tue 1/8/17 Wed 16/8/17 1.1 Conceptual design 14 Tue 1/8/17 Mon 14/8/17 1.2 Criteria development & conceptual design reviews 2 Tue 15/8/17 Wed 16/8/17 2 Construction Preparation 30 Mon 21/8/17 Wed 20/9/17 2.1 Mobilization 21 Mon 21/8/17 Sun 10/9/17 2.1.1 Site possession 0 Mon 21/8/17 Mon 21/8/17 2.1.2 Site survey 7 Mon 21/8/17 Sun 27/8/17 2.1.3 Plant & Machinery 14 Mon 28/8/17 Mon 11/9/17 2.2 Site Preparation 9 Tue 12/9/17 Wed 20/9/17 2.2.1 Site clearing 3 Tue 12/9/17 Thu 14/9/17 2.2.2 General excavation 3 Fri 15/9/17 Sat 16/9/17 2.2.3 Grading general area 3 Sun 17/9/17 Wed 20/9/17 3 Construction 430 Mon 25/9/17 3.1 Substructure 176 Mon 25/9/17 Sun 1/4/18 3.1.1 Basement 176 Mon 25/9/17 Fri 1/4/18 3.1.1.1 Excavating for basements (B1 & B2) 78 Mon 25/9/17 Thu 14/12/17 3.1.1.2 Retaining walls 65 Mon 18/12/17 Tue 27/2/18 3.1.1.3 Damp proof course 65 Mon 18/12/17 Tue 27/2/18 3.1.1.4 Basement structures 33 Wed 28/2/18 Sun 1/4/18 3.1.1.5 Ramps 26 Wed 7/3/18 Sun 1/4/18 3.1.2 Foundation 38 Tue 2/1/18 Sun 11/2/18 3.1.2.1 Piling 38 Tue 2/1/18 Sun 11/2/18 3.2 Superstructure 254 Mon 2/4/18 3.2.1 Frame 58 Mon 2/4/18 Wed 30/5/18 3.2.1.1 Columns 48 Mon 2/4/18 Sun 20/5/18 3.2.1.2 Beams 43 Tue 17/4/18 Wed 30/5/18 3.2.2 Upper Floors 30 Sat 2/6/18 Sun 1/7/18 3.2.2.1 Floor structures 30 Sat 2/6/18 Sun 1/7/18
  • 18.
    Page | 18 3.2.3Roof 25 Sat 2/6/18 Tue 26/6/18 3.2.3.1 Roof structures 15 Sat 2/6/18 Sat 16/6/18 3.2.3.2 Roof covering 10 Sun 17/6/18 Tue 26/6/18 3.2.3 Vertical Transportation 30 Sat 2/6/18 Sun 1/7/18 3.2.3.1 Stairs structure 30 Sat 2/6/18 Sun 1/7/18 3.2.3.2 Lifts pit 12 Sat 2/6/18 Wed 13/6/18 3.2.4 External Walls 76 Sat 2/6/18 Sat 18/8/18 3.2.4.1 Masonry work 76 Sat 2/6/18 Sat 18/8/18 3.2.5 Internal Walls 46 Wed 27/6/18 Mon 13/8/18 3.2.5.1 Masonry work 43 Wed 27/6/18 Fri 10/8/18 3.2.5.2 Partitions 31 Fri 13/7/18 Mon 13/8/18 3.2.6 Doors and Windows 26 Mon 20/8/18 Sat 15/9/18 3.2.6.1 Door & window frame 22 Mon 20/8/18 Tue 22/9/18 3.2.6.2 Door & window leaves 17 Wed 29/8/18 Sat 15/9/18 3.3 Building Finishes 80 Tue 14/8/18 Mon 5/11/18 3.3.1 Internal wall finishes 15 Tue 14/8/18 Thu 30/8/18 3.3.2 External wall finishes 15 Mon 20/8/18 Tue 4/9/18 3.3.3 Floor finishes 20 Fri 31/8/18 Thu 20/9/18 3.3.4 Ceiling finishes 20 Fri 21/9/18 Wed 10/10/18 3.3.5 Staircase finishes 20 Fri 31/8/18 Thu 20/9/18 3.3.6 Basement finishes 25 Thu 11/10/18 Mon 5/11/18 3.4 Furnishings and Fittings 25 Tue 6/11/18 Sat 1/12/18 3.4.1 Furniture 10 Tue 6/11/18 Thu 15/11/18 3.4.2 Equipment 25 Tue 6/11/18 Sat 1/12/18 3.4.3 Sanitary wares 16 Tue 6/11/18 Thu 22/11/18 3.5 M&E Works 45 Tue 6/11/18 Fri 21/12/18 3.5.1 Plumbing 45 Tue 6/11/18 Fri 21/12/18 3.5.2 Electrical 34 Sat 17/11/18 Fri 21/12/18 3.5.3 Air-conditioning 27 Sun 25/11/18 Fri 21/12/18 3.5.4 Fire protection 29 Fri 23/11/18 Fri 21/12/18
  • 19.
    Page | 19 3.5.5Lift 10 Wed 12/12/18 Fri 21/12/18 3.6 Infrastructure Works 57 Tue 6/11/18 Sat 5/1/19 3.6.1 Sewerage works 57 Tue 6/11/18 Sat 5/1/19 3.6.2 Surface water drainage 55 Thu 8/11/18 Sat5/1/19 3.6.3 External reticulation works for M&E 24 Fri 21/12/18 Thu 17/1/19 3.6.4 Road works 33 Tue 6/11/18 Thu 20/12/18 3.6.5 Road kerbs 24 Thu 20/12/18 Tue 15/1/19 3.6.6 Walkway 20 Mon 24/12/18 Tue 15/1/19 3.6.7 Underground cable services 25 Tue 6/11/18 Sat 1/12/18 3.6.8 Fencing 30 Wed 14/11/18 Fri 14/12/18 3.6.9 Landscaping 20 Thu 13/12/18 Sat 5/1/19 4 Demobilization 30 Mon 7/1/19 Fri 1/2/19 4.1 Testing and Commissioning 20 Mon 7/1/19 Sat 26/1/19 4.2 Cleaning and Clearing 10 Mon 28/1/19 Fri 1/2/19
  • 20.
    Page | 20 7.0Project Cost Estimation Project underestimation of resources and costs is one of the most common contributors to project failure. Thus, project managers should have a sound knowledge of the various construction techniques and tools in the defining and executing the project cost estimation. As defined by the Project Management Body of Knowledge (PMBOK), cost estimation is the iterative process of developing an approximation of the monetary resources needed to complete project activities. The cost that is associated with this project include both the initial capital cost and the subsequent operation and maintenance costs. As always, the client will want to achieve the lowest possible net project cost keeping in mind the investment cost and how to recover his money. But the scale of these cost components will be subjected to the nature, size and location of the project itself. In order to accurately produce a cost estimate for this project, construction cost handbook for like JUBM and Langdon Seah Construction has been used to obtained the relevant cost data which are up to date. Construction cost data fit for this project are related to underground car park, medium rise offices and retail outlets. Other costs like for example the development cost which includes numerous cost like professional fees, legal fees, administrative fees, planning fees and contingencies are based on percentage of the total construction cost. 7.1 Data used for estimating project cost (1) Construction Cost (L&S cost handbook related to Kuala Lumpur) i. Average Standard offices (Lecture Theaters) RM 2470/m2 (inclusive of services) ii. Average Standard offices (X-space) RM 2470/m2 (inclusive of services) iii. Food retail outlets RM 2760/m2 (inclusive of services) iv. Basement carparks(less than 3 levels) RM 1475/m2 (inclusive of services)
  • 21.
    Page | 21 (2)Development Cost i. Professional Fees : 8% of construction costs ii. Administrative Fees : 2% of construction costs iii. Plan Fees : 2% of construction costs iv. Legal Fees : 1% of construction costs v. Contingencies : 5% of construction costs 7.2 Gross Development Cost (a) Construction Cost No Type No. of Floors Net Build Up Area (m2) Construction Cost (RM/m2) from L&S Construction Cost (RM/m2) for this project Construction Cost (RM) 1 Basement Car Parks 2 2400 1,475.00 1,475.00 3,540,000.00 2 Food Retail Outlets 1 1200 2,760.00 2,760.00 3,312,000.00 3 Lecture Theaters 3 3600 2,470.00 (subjected to 10%) 2,717.00 9,781,200.00 4 X-space classroom 1 1200 2,470.00 (subjected to 10%) 2,717.00 3,260,400.00 NET TOTAL 7 8400 19,893,600.00 Assumption: Increase the price for the lecture theaters and the X-space classroom by 10% due to the special furniture and digital accessories. Assumption: The cost data include circulation spaces and ancillary services like toilets, staircases, lifts and walkways.
  • 22.
    Page | 22 (b)Development Cost No. % Allocation Construction Cost (RM) Development Cost (RM) 1 Professional Fees 8% 19,893,600.00 1,591,488.00 2 Administrative Fees 2% 397,872.00 3 Plan Fees 2% 397,872.00 4 Legal Fees 1% 198,936.00 5 Contingencies 5% 994,680.00 NET TOTAL 3,580,848.00 Gross Development Cost (GDC) = Construction cost + Development Cost = RM 19,893,600.00 + RM 3,580,848.00 = RM 23,474,448.00 7.3 Operation and Maintenance Cost A building like this project which is dedicated to the students of the Taylor’s University would carry a consequent cost for operating and maintaining the whole building . Since the client will rent the land for RM 15,000 per month for a period of 20 years and that he will do the whole development under his expense, it is assumed that the client should bear the whole operation and maintenance cost without any help from Taylor’s University. But without proper communication with the management of university, the client will not be able to accurately estimate the monthly operation and maintenance cost. It is imperative that the client liaise with the university. Also, to cater for any inflation in prices, it is assumed that the monthly expenses should be subjected to a 5% increase every 5 years. The monthly expenses obtained for 1 block are as follows:
  • 23.
    Page | 23 Electricityand water : RM 100,000 Repairing cost : RM 20,000 Cleaning cost : RM 20,000 Now these costs are for one block which contains operating and maintaining costs for 11 fully operated floors. Using the prices above, the expenses for the new academic block are calculated accordingly and it will also include the monthly rental for the land bearing in mind that there will not be any cleaning cost and repairing cost at it is the construction period. Monthly expenses for new building Electricity and water 60,000.00 Repairing cost 10,000.00 Cleaning cost 10,000.00 Land Rental 15,000.00 NET TOTAL 95,000.00 % increase Monthly Expenses for new building (RM) Yearly Expenses (RM) TOTAL Expenses (RM) Year 1 (12months) 15,000.00 180,000.00 180,000.00 Year 2 to 5 (48 months) 95,000.00 1,140,000.00 4,560,000 Year 6 to 10 (60 months) 5% 99,750.00 1,197,000.00 5,985,000.00 Year 11 to 15 (60 months) 5% 104,737.50 1,256,850.00 6,284,250.00 Year 15 to 20 (60 months) 5% 109,974.38 1,319,704.50 6,598,462.50 NET TOTAL 23,607,712.50
  • 24.
    Page | 24 Therefore,the following outlines the whole estimated project cost; Gross Development Cost RM 23,474,448.00 Operation & Maintenance cost RM 23,607,712.50 Total Estimated Project cost RM 47,082,160.50 8.0 Projected Earnings In this section, it will be clearly stated how the yearly earnings will be calculated as this will determine the income of the client over the period of his 20 years’ contract with Taylor’s University. The following earnings which the client will benefit while renting the mentioned facilities of the new building: (1) Season paring charges only (2) Monthly rental of the lecture theaters (3) Monthly rental of the X-Space classrooms (4) Monthly rental of the food retail outlets Below are the projected earnings for the season parking, the food retail outlets, the lecture theaters and the X-space classrooms respectively. It is to be noted that the first year is dedicated to the construction period, thus there will not be any earnings in the first year.
  • 25.
    Page | 25 8.1Season Parking The current season parking fee for Taylor’s University is RM 120/month. To maintain consistency along with Taylor’s University charges, the season parking fee will also be RM 120/month. The projected earnings are as followed: Season Parking charge/lot = RM 120/ month Number of Parking Lots = 144 lots (2 levels x 72 lots/level) Monthly Earnings = RM 120 x 144 = RM 17,280 Yearly Earnings = RM 17,280 x 12 = RM 207,360.00 Year Remarks Yearly Earnings (RM) Total Earnings (RM) 2 - 5 - 207,360.00 829,440.00 6 - 10 Fees increases by 5% 217,728.00 1,088,640.00 11 - 15 Fees increases by 5% 228,614.00 1,143,070.00 16 - 20 Fees increases by 5% 240,045.00 1,200,225.00 NET TOTAL 4,261,375.00
  • 26.
    Page | 26 8.2Food Retails It is assumed that the rental price for the retail on the ground floor will be RM 7,000. This rate is obtained after comparing with the different rental of retail in the area. The rental price does not include the utility bills as the retailers are expected to pay for it on their own. The projected earnings are as followed: Rental Fees/Retail Lot = RM 7,000/ month Number of Retail Lots = 6 Monthly Earnings = RM 7,000 x 6 = RM 42,000 Yearly Earnings = RM 42,000 x 12 = RM 504,000 Year Remarks Yearly Earnings (RM) Total Earnings (RM) 2 - 5 - 504,000.00 2,016,000.00 6 - 10 Fees increases by 5% 529,200.00 2,646,000.00 11 - 15 Fees increases by 5% 555,660.00 2,778,000.00 16 - 20 Fees increases by 5% 583,443.00 2,917,215.00 NET TOTAL 10,357,215.00
  • 27.
    Page | 27 8.3Lecture Theaters The rental for the Lecture Theaters will be priced at RM 9,000 each month. The rental is high due to the amount of electricity that would be used daily for the air conditioning, lighting and the projector. The projected earnings are calculated: Rental Fees/Lecture Theater = RM 9,000/ month Number of Lecture Theaters = 15 Monthly Earnings = RM 9,000 x 15 = RM 135,000 Yearly Earnings = RM 135,000 x 12 = RM 1,620,000 Year Remarks Yearly Earnings (RM) Total Earnings (RM) 2 - 5 - 1,620,000.00 6,480,000.00 6 - 10 Fees increases by 5% 1,701,000.00 8,505,000.00 11 - 15 Fees increases by 5% 1,786,050.00 8,930,250.00 16 - 20 Fees increases by 5% 1,875,352.50 9,376,762.50 NET TOTAL 33,292,012.50
  • 28.
    Page | 28 8.4X-Space Classrooms The rental for the X-Space classrooms will be priced at RM 9,000 each month. The rental is high due to the amount of electricity that would be used daily for the air conditioning, lighting and the projector. The projected earnings are as followed: Rental Fees/Lecture Theater = RM 9,000/ month Number of Lecture Theaters = 7 Monthly Earnings = RM 9,000 x 7 = RM 63,000 Yearly Earnings = RM 63,000 x 12 = RM 756,000 Year Remarks Yearly Earnings (RM) Total Earnings (RM) 2 - 5 - 756,000.00 3,024,000.00 6 - 10 Fees increases by 5% 793,800.00 3,969,000.00 11 - 15 Fees increases by 5% 833,490.00 4,167,450.00 16 - 20 Fees increases by 5% 875,164.50 4,375,822.50 NET TOTAL 15,536,272.50
  • 29.
    Page | 29 8.4Summary of Project Earnings Season Parking = 4,261,375.00 Retail = 10,357,215.00 Lecture Theater = 33,292,012.50 X-Space = 15,536,272.50 TOTAL = 63,446,875.00
  • 30.
    Page | 30 8.5Net Present Value (NPV) Year Inflow Outflow Net Cash Flow PV Factor @ 5% PV Value @ 5% 0 23,654,448.00 -23,654,448.00 1 -23,654,448.00 1 3,087,360.00 1,140,000.00 1,947,360.00 0.9524 1,854,665.66 2 3,087,360.00 1,140,000.00 1,947,360.00 0.907 1,766,255.52 3 3,087,360.00 1,140,000.00 1,947,360.00 0.8638 1,682,129.57 4 3,087,360.00 1,140,000.00 1,947,360.00 0.8227 1,602,093.07 5 3,087,360.00 1,197,000.00 1,890,360.00 0.7835 1,481,097.06 6 3,241,728.00 1,197,000.00 2,044,728.00 0.7462 1,525,776.03 7 3,241,728.00 1,197,000.00 2,044,728.00 0.7107 1,453,188.19 8 3,241,728.00 1,197,000.00 2,044,728.00 0.6768 1,383,871.91 9 3,241,728.00 1,197,000.00 2,044,728.00 0.6446 1,318,031.67 10 3,241,728.00 1,256,850.00 1,984,878.00 0.6139 1,218,516.60 11 3,403,814.00 1,256,850.00 2,146,964.00 0.5847 1,255,329.85 12 3,403,814.00 1,256,850.00 2,146,964.00 0.5568 1,195,429.56 13 3,403,814.00 1,256,850.00 2,146,964.00 0.5303 1,138,535.01 14 3,403,814.00 1,256,850.00 2,146,964.00 0.5051 1,084,431.52 15 3,403,814.00 1,319,704.50 2,084,109.50 0.481 1,002,456.67 16 3,574,005.00 1,319,704.50 2,254,300.50 0.4581 1,032,695.06 17 3,574,005.00 1,319,704.50 2,254,300.50 0.4363 983,551.31 18 3,574,005.00 1,319,704.50 2,254,300.50 0.4155 936,661.86 19 3,574,005.00 1,319,704.50 2,254,300.50 0.3957 892,026.71 NET PRESENT VALUE 1,152,294.82 *First year cash outflow = RM 23,474,448 + RM 180,000 (rental for first year) = RM 23,654,448.00 *The reason to why we have only 19 years while calculating the NPV is that the first financial year is accounted as the year 0 in the NPV table.
  • 31.
    Page | 31 8.6Viability of project The reason why the NPV was calculated is to find whether this project will benefit the client or not. By having a positive NPV at a PV factor of 5%, Its shows that this project is acceptable and can proceed with the development. 8.7 Net Profit over the 20 years Estimated project earnings for 20 years RM 63,446,875.00 Invested GDC -RM 23,474,448.00 Operation and maintenance cost for 20 years -RM 23,607,712.50 NET PROFIT RM 16,364,714.50 9.0 Project Summary/ Conclusion As a summary, the proposed project is an additional block which comprises of 7 floors with 2 levels of basement parking spaces, 1 floor of food retail outlets which located on ground floor, 3 floors of lecture theater units and X-space units that located on 4th floor. This project is to make sure that it can help Taylor’s University in solving the issues such as insufficient parking spaces, retails and lecture units. Besides that, it also will ease the ascension of Taylor’s University to the most preferred university in Malaysia. For the estimation part, it proved extremely profitable to the client as the estimation above shows that within 20 years of the additional block, the client will be able to make a profit of RM 16,364,714.50. Besides that, this will facilitate the client in term of finances on funding other projects which can lead him to a higher level of success. The students in Taylor’s University can also have a chance to live and study in a better environment through the access of such facilities.
  • 32.
    Page | 32 10.0References Anon, (2017). [online] Available at: http://http//doit.maryland.gov/sdlc/documents/cost estimating.pdf Anon, (2017). [online] Available at: https://www.projectsmart.co.uk/project-management-scope- triangle.php Anon, (2017). [online] Available at: http://www.langdonseah.com/en/sg/files/download/3796 Iproperty.com.my. (2017). Cite a Website - Cite This For Me. [online] Available at: https://www.iproperty.com.my/propertynearby/16879/S/Sunway_Pyramid_ForRent Fichtner, C. (2017). PMBOK Knowledge Areas for Project Management Guide 5th Edition - Process Groups and Processes - The Complete Guide. [online] Project-management- prepcast.com. Available at: https://www.project-management-prepcast.com/pmbok-knowledge- areas-and-pmi-process-groups Hartney, J. (2017). The 10 PMBOK Knowledge Areas. [online] ProjectEngineer. Available at: http://www.projectengineer.net/the-10-pmbok-knowledge-areas/ Padu.edu.my. (2017). PADU | MEB. [online] Available at: http://www.padu.edu.my/meb Pmbook.ce.cmu.edu. (2017). Project Management for Construction: Cost Estimation. [online] Available at: http://pmbook.ce.cmu.edu/05_Cost_Estimation.html Costengineering.eu. (2017). Which are the best techniques for project cost estimating?. [online] Available at: http://www.costengineering.eu/blog-article/which-are-the-best-techniques-for- project-cost-estimating
