This document provides instructions for getting started with Microsoft Project 2010. It covers the basic steps to create a project including starting a new project, adding tasks, milestones, and dependencies, creating a work breakdown structure using summary tasks, assigning resources, and finding the critical path. The document also describes the MS Project interface and provides screenshots to illustrate how to customize calendars, enter recurring tasks, and view resource allocation.
MS Project Integration: Tips, Tricks and What's New for YouCA Technologies
Â
Have you scheduled in Microsoft Project (MSP) and are now presented with the "Tasks" to maintain a schedule in CA Project & Portfolio Manager (CA PPM)? Is your organization using CA PPM but still wants to schedule in MS Project? Have you noticed that the logic in how CA PPM schedules is different in MS Project? And most importantly â wouldn't it be awesome to be able to explain why CA PPM and MS Project behave differently but ultimately get you the same result? This presentation shows you where and how MSP and CA PPM bi-directionally map data, how to create and manage tasks, assignments and scheduling, as well as updating task status and work. It includes a broad discussion where and when data should be entered in CA PPM and MS Project, on defining data elements and how to capture them.
For more information on Management Cloud solutions from CA Technologies, please visit: http://bit.ly/1wEnPhz
MS Project Integration: Tips, Tricks and What's New for YouCA Technologies
Â
Have you scheduled in Microsoft Project (MSP) and are now presented with the "Tasks" to maintain a schedule in CA Project & Portfolio Manager (CA PPM)? Is your organization using CA PPM but still wants to schedule in MS Project? Have you noticed that the logic in how CA PPM schedules is different in MS Project? And most importantly â wouldn't it be awesome to be able to explain why CA PPM and MS Project behave differently but ultimately get you the same result? This presentation shows you where and how MSP and CA PPM bi-directionally map data, how to create and manage tasks, assignments and scheduling, as well as updating task status and work. It includes a broad discussion where and when data should be entered in CA PPM and MS Project, on defining data elements and how to capture them.
For more information on Management Cloud solutions from CA Technologies, please visit: http://bit.ly/1wEnPhz
Installation of primavera (optional)
Open primavera
Create EPS
Create your own project with minimum 30 activities(Live projects are preferable)
Data entry
Inserting activities
Assigning relationship
Activates codes
Basic formatting of Bars(Bar style, Bar label)
Inserting and modifying columns
Group by and short by
User defined filed
Interfering floats
Make 2 more of your self
Filters
New filters
Modify filters
Cases of Constraints
Case of difference between total float and free float
calendar
Import & Export
Live project Information
Filters ( 1-line, 2-line, 3-line Filters)
RESOURCE ASSIGNING AND LEVELLING
Resource Levelling
RESOURCE LOADING (Bell type, front loaded, back loaded, linear etc.)
EARNED VALUE ANALYSIS
Cost Account
Expenses
Reports
Role
User Defined fields
Admin Preferences
Renumbering Activities
Project Portfolio
Edit Columns
Save layout
Working with multiple projectsÂ
Activity Steps
Global change
Multiple Projects
USING WORK PRODUCTS AND DOCUMENTS
UPDATING PROJECT BY "AUTO ACTUALS" METHOD
UPDATING, SCHEDULING PROJECT - WITH SPOTLIGHT FEATURE
ASSIGN BASELINE
MAINTAIN BASELINE
PROJECT CODES
Slides on MS Project covering the following
Project Scheduling
âą Overview and Context
âą Opening Microsoft Project and Customizing the User Interface
âą Starting a New Project
âą Working with Durations and the Time Scale
âą Outlining a Project
âą Linking Tasks
âą Adding Lags to Links
âą Working with Date Constraints
âą Creating and managing Milestones
âą Working with Project Tasks
âą The Critical Path
âą Filters
âą Sorting and Grouping
âą Customizing Fields
âą Other View and Display Options
âą Creating Reports
âą Adding Graphics and Multimedia Objects to the Gantt Area
âą Formatting for Printing
âą Exporting Project Images and Data to Other Applications
âą The Organizer
Resource Management
âą The Resource Sheet
âą Assigning Single Resources to Tasks
âą Assigning Multiple Resources to Tasks
âą Special Tools for Resource Assignment and Cost Estimating
âą Managing Resource Workloads
âą Resource Leveling
âą Working with Calendars
Tracking Progress
âą The Baseline
âą Tracking Progress with the Percent of Completion Method
âą Tracking Actual Hours with the Usage Views
âą Earned Value Concepts
âą Progress Lines and Updating Tools
âą Issues and Problems Arising With Tracking
Multiple Projects
âą Resource Pooling
âą Consolidating Projects
âą Links Among Projects in a Consolidation
Project Planning Basics - Everything you need to start managing a projectKeely Killpack, PhD
Â
This deck covers the basics of managing projects & project teams. Discusses scope, scheduling, issues/risks, templates, planning and recommended details. Everything is covered that would prepare the reader for effectively managing a project.
This course is a detailed course about Primavera Project Management.
The course contains so many details about the software and its relation to the project management science.
the material consists of 7 sessions.
this material is a primer effort and might be updated then uploaded.
I hope it will be beneficial to the persons who cares about project management.
You need to create a formal document that can be used to guide project execution and control. Get this template @ http://www.demandmetric.com/content/project-plan-template
Our Primavera P6 Professional Advanced Topics course is a the final course in our Primavera P6 Professional learning path, This class follows on from our Primavera P6 Professional Fundamentals and our Scheduling Best Practice Guidelines for Primavera P6 online video training courses. Take your understanding of Primavera P6 to the next level with this in-depth look at the more advanced features in common use by top P6 schedulers.
Installation of primavera (optional)
Open primavera
Create EPS
Create your own project with minimum 30 activities(Live projects are preferable)
Data entry
Inserting activities
Assigning relationship
Activates codes
Basic formatting of Bars(Bar style, Bar label)
Inserting and modifying columns
Group by and short by
User defined filed
Interfering floats
Make 2 more of your self
Filters
New filters
Modify filters
Cases of Constraints
Case of difference between total float and free float
calendar
Import & Export
Live project Information
Filters ( 1-line, 2-line, 3-line Filters)
RESOURCE ASSIGNING AND LEVELLING
Resource Levelling
RESOURCE LOADING (Bell type, front loaded, back loaded, linear etc.)
EARNED VALUE ANALYSIS
Cost Account
Expenses
Reports
Role
User Defined fields
Admin Preferences
Renumbering Activities
Project Portfolio
Edit Columns
Save layout
Working with multiple projectsÂ
Activity Steps
Global change
Multiple Projects
USING WORK PRODUCTS AND DOCUMENTS
UPDATING PROJECT BY "AUTO ACTUALS" METHOD
UPDATING, SCHEDULING PROJECT - WITH SPOTLIGHT FEATURE
ASSIGN BASELINE
MAINTAIN BASELINE
PROJECT CODES
Slides on MS Project covering the following
Project Scheduling
âą Overview and Context
âą Opening Microsoft Project and Customizing the User Interface
âą Starting a New Project
âą Working with Durations and the Time Scale
âą Outlining a Project
âą Linking Tasks
âą Adding Lags to Links
âą Working with Date Constraints
âą Creating and managing Milestones
âą Working with Project Tasks
âą The Critical Path
âą Filters
âą Sorting and Grouping
âą Customizing Fields
âą Other View and Display Options
âą Creating Reports
âą Adding Graphics and Multimedia Objects to the Gantt Area
âą Formatting for Printing
âą Exporting Project Images and Data to Other Applications
âą The Organizer
Resource Management
âą The Resource Sheet
âą Assigning Single Resources to Tasks
âą Assigning Multiple Resources to Tasks
âą Special Tools for Resource Assignment and Cost Estimating
âą Managing Resource Workloads
âą Resource Leveling
âą Working with Calendars
Tracking Progress
âą The Baseline
âą Tracking Progress with the Percent of Completion Method
âą Tracking Actual Hours with the Usage Views
âą Earned Value Concepts
âą Progress Lines and Updating Tools
âą Issues and Problems Arising With Tracking
Multiple Projects
âą Resource Pooling
âą Consolidating Projects
âą Links Among Projects in a Consolidation
Project Planning Basics - Everything you need to start managing a projectKeely Killpack, PhD
Â
This deck covers the basics of managing projects & project teams. Discusses scope, scheduling, issues/risks, templates, planning and recommended details. Everything is covered that would prepare the reader for effectively managing a project.
This course is a detailed course about Primavera Project Management.
The course contains so many details about the software and its relation to the project management science.
the material consists of 7 sessions.
this material is a primer effort and might be updated then uploaded.
I hope it will be beneficial to the persons who cares about project management.
You need to create a formal document that can be used to guide project execution and control. Get this template @ http://www.demandmetric.com/content/project-plan-template
Our Primavera P6 Professional Advanced Topics course is a the final course in our Primavera P6 Professional learning path, This class follows on from our Primavera P6 Professional Fundamentals and our Scheduling Best Practice Guidelines for Primavera P6 online video training courses. Take your understanding of Primavera P6 to the next level with this in-depth look at the more advanced features in common use by top P6 schedulers.
This presentation explains the MS Project with proper steps. An example of particular project is taken and various steps such as creating project, WBS, adding outdent, indent, auto scheduling, setting up predecessors, adding Gantt bar chart, formula's, creating columns, assigning responsibilities, resources, changing currency, levelling over allocated resources, types of filters, switch anf iff function, calendar, macros, multiple project, earned value, report generation are explained.
Study MaterialUseful for All Civil Engineering Exams
1.The main reinforcement in a heel of cantilever retaining wall is placed atTop of heel slab.
2.Which of the following oxide component is maximum in OPC cement Calcium.
3.According to IS:456, the partial safety Ë ffor imposed load for the deflection check for load combination DL+IL shall be 1.0
4.The compressive strength of cement mortar is generally tested on 70.7mm Cubes
5.Product of AE is called Axial Rigidity.
6.If the diameter of circular column is d its kernel will have diameter d/4.
Did you know that content curation is a fantastic branding tool? Discover why in this presentation by Cendrine Marrouat.
Content:
- What is content curation?
- Why content curation?
- Benefits of content curation
- Ideas to leverage content curation
- Examples of content to curate
- Examples of content curation tools
- Tips to become a great content curator
- A few great curators to follow
Learn MS Project Software Free PDF Download - Nice Presentation done by Bhadanis Quantity Surveying Institute Call 9990990844 or visit www.billingengineer.com
Check out the webinar slides to learn more about how XfilesPro transforms Salesforce document management by leveraging its world-class applications. For more details, please connect with sales@xfilespro.com
If you want to watch the on-demand webinar, please click here: https://www.xfilespro.com/webinars/salesforce-document-management-2-0-smarter-faster-better/
Understanding Nidhi Software Pricing: A Quick Guide đ
Choosing the right software is vital for Nidhi companies to streamline operations. Our latest presentation covers Nidhi software pricing, key factors, costs, and negotiation tips.
đ What Youâll Learn:
Key factors influencing Nidhi software price
Understanding the true cost beyond the initial price
Tips for negotiating the best deal
Affordable and customizable pricing options with Vector Nidhi Software
đ Learn more at: www.vectornidhisoftware.com/software-for-nidhi-company/
#NidhiSoftwarePrice #NidhiSoftware #VectorNidhi
Globus Compute wth IRI Workflows - GlobusWorld 2024Globus
Â
As part of the DOE Integrated Research Infrastructure (IRI) program, NERSC at Lawrence Berkeley National Lab and ALCF at Argonne National Lab are working closely with General Atomics on accelerating the computing requirements of the DIII-D experiment. As part of the work the team is investigating ways to speedup the time to solution for many different parts of the DIII-D workflow including how they run jobs on HPC systems. One of these routes is looking at Globus Compute as a way to replace the current method for managing tasks and we describe a brief proof of concept showing how Globus Compute could help to schedule jobs and be a tool to connect compute at different facilities.
Globus Connect Server Deep Dive - GlobusWorld 2024Globus
Â
We explore the Globus Connect Server (GCS) architecture and experiment with advanced configuration options and use cases. This content is targeted at system administrators who are familiar with GCS and currently operateâor are planning to operateâbroader deployments at their institution.
Enhancing Research Orchestration Capabilities at ORNL.pdfGlobus
Â
Cross-facility research orchestration comes with ever-changing constraints regarding the availability and suitability of various compute and data resources. In short, a flexible data and processing fabric is needed to enable the dynamic redirection of data and compute tasks throughout the lifecycle of an experiment. In this talk, we illustrate how we easily leveraged Globus services to instrument the ACE research testbed at the Oak Ridge Leadership Computing Facility with flexible data and task orchestration capabilities.
Navigating the Metaverse: A Journey into Virtual Evolution"Donna Lenk
Â
Join us for an exploration of the Metaverse's evolution, where innovation meets imagination. Discover new dimensions of virtual events, engage with thought-provoking discussions, and witness the transformative power of digital realms."
Innovating Inference - Remote Triggering of Large Language Models on HPC Clus...Globus
Â
Large Language Models (LLMs) are currently the center of attention in the tech world, particularly for their potential to advance research. In this presentation, we'll explore a straightforward and effective method for quickly initiating inference runs on supercomputers using the vLLM tool with Globus Compute, specifically on the Polaris system at ALCF. We'll begin by briefly discussing the popularity and applications of LLMs in various fields. Following this, we will introduce the vLLM tool, and explain how it integrates with Globus Compute to efficiently manage LLM operations on Polaris. Attendees will learn the practical aspects of setting up and remotely triggering LLMs from local machines, focusing on ease of use and efficiency. This talk is ideal for researchers and practitioners looking to leverage the power of LLMs in their work, offering a clear guide to harnessing supercomputing resources for quick and effective LLM inference.
Quarkus Hidden and Forbidden ExtensionsMax Andersen
Â
Quarkus has a vast extension ecosystem and is known for its subsonic and subatomic feature set. Some of these features are not as well known, and some extensions are less talked about, but that does not make them less interesting - quite the opposite.
Come join this talk to see some tips and tricks for using Quarkus and some of the lesser known features, extensions and development techniques.
Do you want Software for your Business? Visit Deuglo
Deuglo has top Software Developers in India. They are experts in software development and help design and create custom Software solutions.
Deuglo follows seven steps methods for delivering their services to their customers. They called it the Software development life cycle process (SDLC).
RequirementâââCollecting the Requirements is the first Phase in the SSLC process.
Feasibility Studyâââafter completing the requirement process they move to the design phase.
Designâââin this phase, they start designing the software.
Codingâââwhen designing is completed, the developers start coding for the software.
Testingâââin this phase when the coding of the software is done the testing team will start testing.
Installationâââafter completion of testing, the application opens to the live server and launches!
Maintenanceâââafter completing the software development, customers start using the software.
OpenMetadata Community Meeting - 5th June 2024OpenMetadata
Â
The OpenMetadata Community Meeting was held on June 5th, 2024. In this meeting, we discussed about the data quality capabilities that are integrated with the Incident Manager, providing a complete solution to handle your data observability needs. Watch the end-to-end demo of the data quality features.
* How to run your own data quality framework
* What is the performance impact of running data quality frameworks
* How to run the test cases in your own ETL pipelines
* How the Incident Manager is integrated
* Get notified with alerts when test cases fail
Watch the meeting recording here - https://www.youtube.com/watch?v=UbNOje0kf6E
We describe the deployment and use of Globus Compute for remote computation. This content is aimed at researchers who wish to compute on remote resources using a unified programming interface, as well as system administrators who will deploy and operate Globus Compute services on their research computing infrastructure.
Need for Speed: Removing speed bumps from your Symfony projects âĄïžĆukasz ChruĆciel
Â
No one wants their application to drag like a car stuck in the slow lane! Yet itâs all too common to encounter bumpy, pothole-filled solutions that slow the speed of any application. Symfony apps are not an exception.
In this talk, I will take you for a spin around the performance racetrack. Weâll explore common pitfalls - those hidden potholes on your application that can cause unexpected slowdowns. Learn how to spot these performance bumps early, and more importantly, how to navigate around them to keep your application running at top speed.
We will focus in particular on tuning your engine at the application level, making the right adjustments to ensure that your system responds like a well-oiled, high-performance race car.
Software Engineering, Software Consulting, Tech Lead, Spring Boot, Spring Cloud, Spring Core, Spring JDBC, Spring Transaction, Spring MVC, OpenShift Cloud Platform, Kafka, REST, SOAP, LLD & HLD.
GraphSummit Paris - The art of the possible with Graph TechnologyNeo4j
Â
Sudhir Hasbe, Chief Product Officer, Neo4j
Join us as we explore breakthrough innovations enabled by interconnected data and AI. Discover firsthand how organizations use relationships in data to uncover contextual insights and solve our most pressing challenges â from optimizing supply chains, detecting fraud, and improving customer experiences to accelerating drug discoveries.
Essentials of Automations: The Art of Triggers and Actions in FMESafe Software
Â
In this second installment of our Essentials of Automations webinar series, weâll explore the landscape of triggers and actions, guiding you through the nuances of authoring and adapting workspaces for seamless automations. Gain an understanding of the full spectrum of triggers and actions available in FME, empowering you to enhance your workspaces for efficient automation.
Weâll kick things off by showcasing the most commonly used event-based triggers, introducing you to various automation workflows like manual triggers, schedules, directory watchers, and more. Plus, see how these elements play out in real scenarios.
Whether youâre tweaking your current setup or building from the ground up, this session will arm you with the tools and insights needed to transform your FME usage into a powerhouse of productivity. Join us to discover effective strategies that simplify complex processes, enhancing your productivity and transforming your data management practices with FME. Letâs turn complexity into clarity and make your workspaces work wonders!
Utilocate offers a comprehensive solution for locate ticket management by automating and streamlining the entire process. By integrating with Geospatial Information Systems (GIS), it provides accurate mapping and visualization of utility locations, enhancing decision-making and reducing the risk of errors. The system's advanced data analytics tools help identify trends, predict potential issues, and optimize resource allocation, making the locate ticket management process smarter and more efficient. Additionally, automated ticket management ensures consistency and reduces human error, while real-time notifications keep all relevant personnel informed and ready to respond promptly.
The system's ability to streamline workflows and automate ticket routing significantly reduces the time taken to process each ticket, making the process faster and more efficient. Mobile access allows field technicians to update ticket information on the go, ensuring that the latest information is always available and accelerating the locate process. Overall, Utilocate not only enhances the efficiency and accuracy of locate ticket management but also improves safety by minimizing the risk of utility damage through precise and timely locates.
Providing Globus Services to Users of JASMIN for Environmental Data AnalysisGlobus
Â
JASMIN is the UKâs high-performance data analysis platform for environmental science, operated by STFC on behalf of the UK Natural Environment Research Council (NERC). In addition to its role in hosting the CEDA Archive (NERCâs long-term repository for climate, atmospheric science & Earth observation data in the UK), JASMIN provides a collaborative platform to a community of around 2,000 scientists in the UK and beyond, providing nearly 400 environmental science projects with working space, compute resources and tools to facilitate their work. High-performance data transfer into and out of JASMIN has always been a key feature, with many scientists bringing model outputs from supercomputers elsewhere in the UK, to analyse against observational or other model data in the CEDA Archive. A growing number of JASMIN users are now realising the benefits of using the Globus service to provide reliable and efficient data movement and other tasks in this and other contexts. Further use cases involve long-distance (intercontinental) transfers to and from JASMIN, and collecting results from a mobile atmospheric radar system, pushing data to JASMIN via a lightweight Globus deployment. We provide details of how Globus fits into our current infrastructure, our experience of the recent migration to GCSv5.4, and of our interest in developing use of the wider ecosystem of Globus services for the benefit of our user community.
3. European
Commission

MS Project overview: Strengths
ï¶ Microsoft Project is a project management software program,
developed and sold by Microsoft, which is designed to assist a
project manager in developing a plan, assigning resources to tasks,
tracking progress, managing the budget, and analysing workloads.
ï¶ The first commercial version of Project was released for DOS in
1984
ï¶ The most widely used PM program because:
ï§ It is fairly generic in its approach
ï§ Highly automated once configured. Requires relatively low amount of user
manipulation
ï§ Scalable â can be used for small to enormous projects
ï§ Balances visual approach (charts, graphs, etc) with logical structured approach
(task and resources lists)
Getting started with Microsoft Project 2010
4. European
Commission
Initiating
âą Set the project goal
âą Identify the necessary start or finish date limitations
âą Identify the project manager
âą Identify budget and quality considerations
âą Enter project tasks, duration and relationships
âą Identify project milestones
âą Define available resources and costs
âą Assign resources to tasks
âą Producing work results
âą Requesting changes
âą Recommending improvements
âą Creating project records, reports, and presentations
âą Updating project
âą Managing resources and tasks
âą Meet management timing, resource, and cost objectives
âą Identify budget and quality considerations
âą Review and analyze performance of the project
âą Create a Closure Report
âą Archive records
Planning
Executing
Controlling
Closing
Project
Management:
process of initiating,
planning, executing,
controlling, and
closing a project

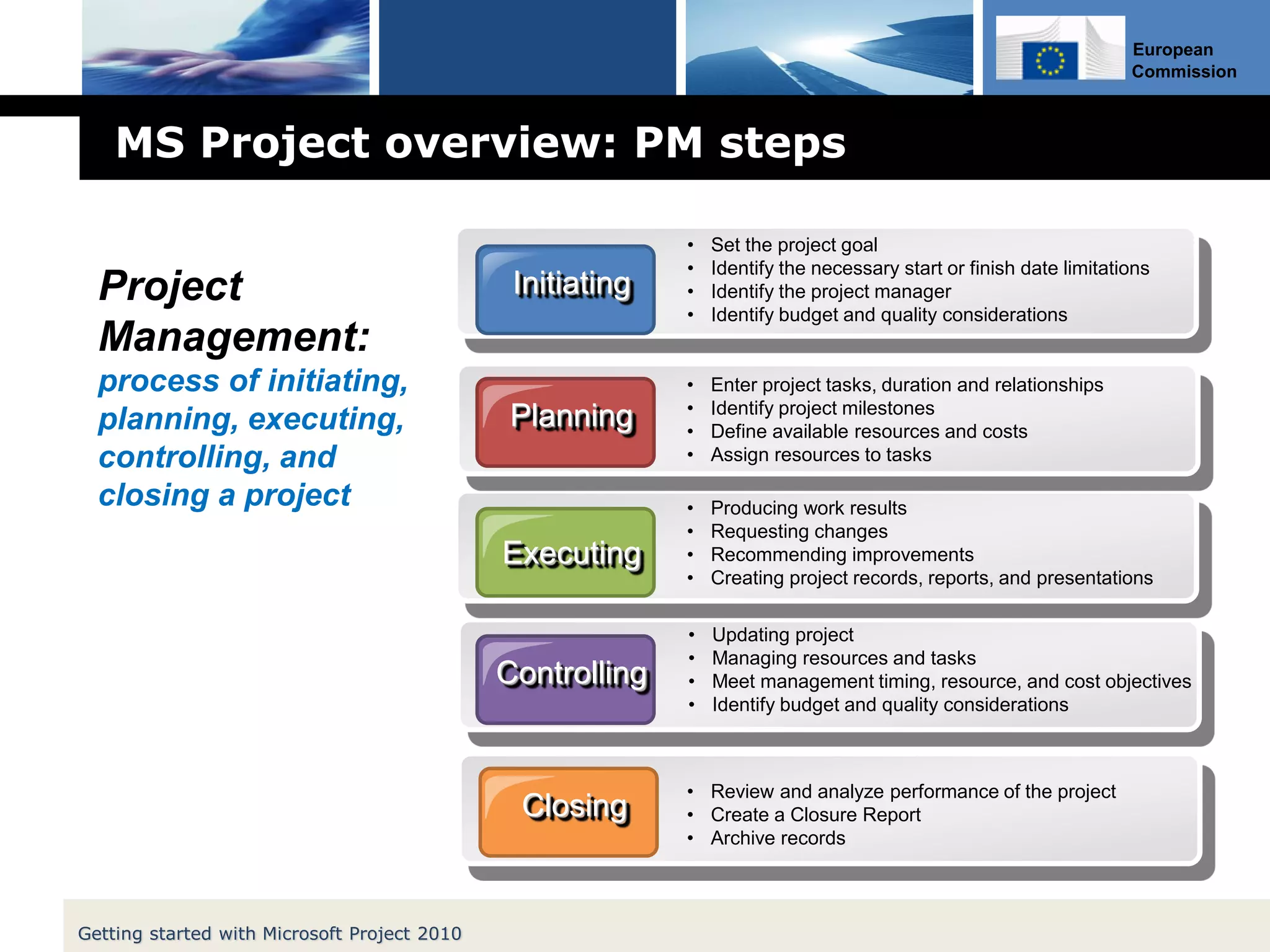

MS Project overview: PM steps
Getting started with Microsoft Project 2010
6. European
Commission

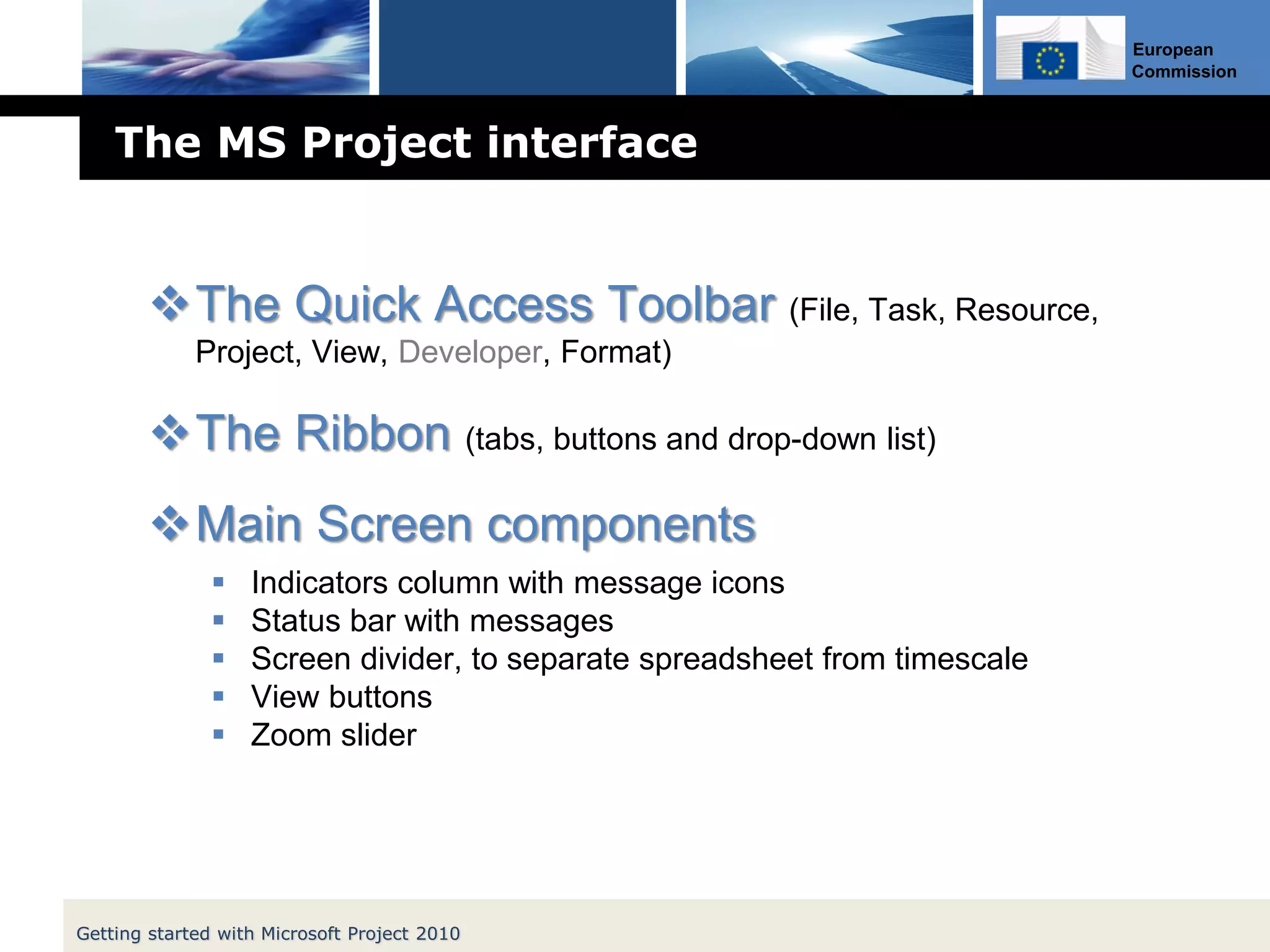

The MS Project interface
ï¶The Quick Access Toolbar (File, Task, Resource,
Project, View, Developer, Format)
ï¶The Ribbon (tabs, buttons and drop-down list)
ï¶Main Screen components
ï§ Indicators column with message icons
ï§ Status bar with messages
ï§ Screen divider, to separate spreadsheet from timescale
ï§ View buttons
ï§ Zoom slider
Getting started with Microsoft Project 2010
9. European
Commission

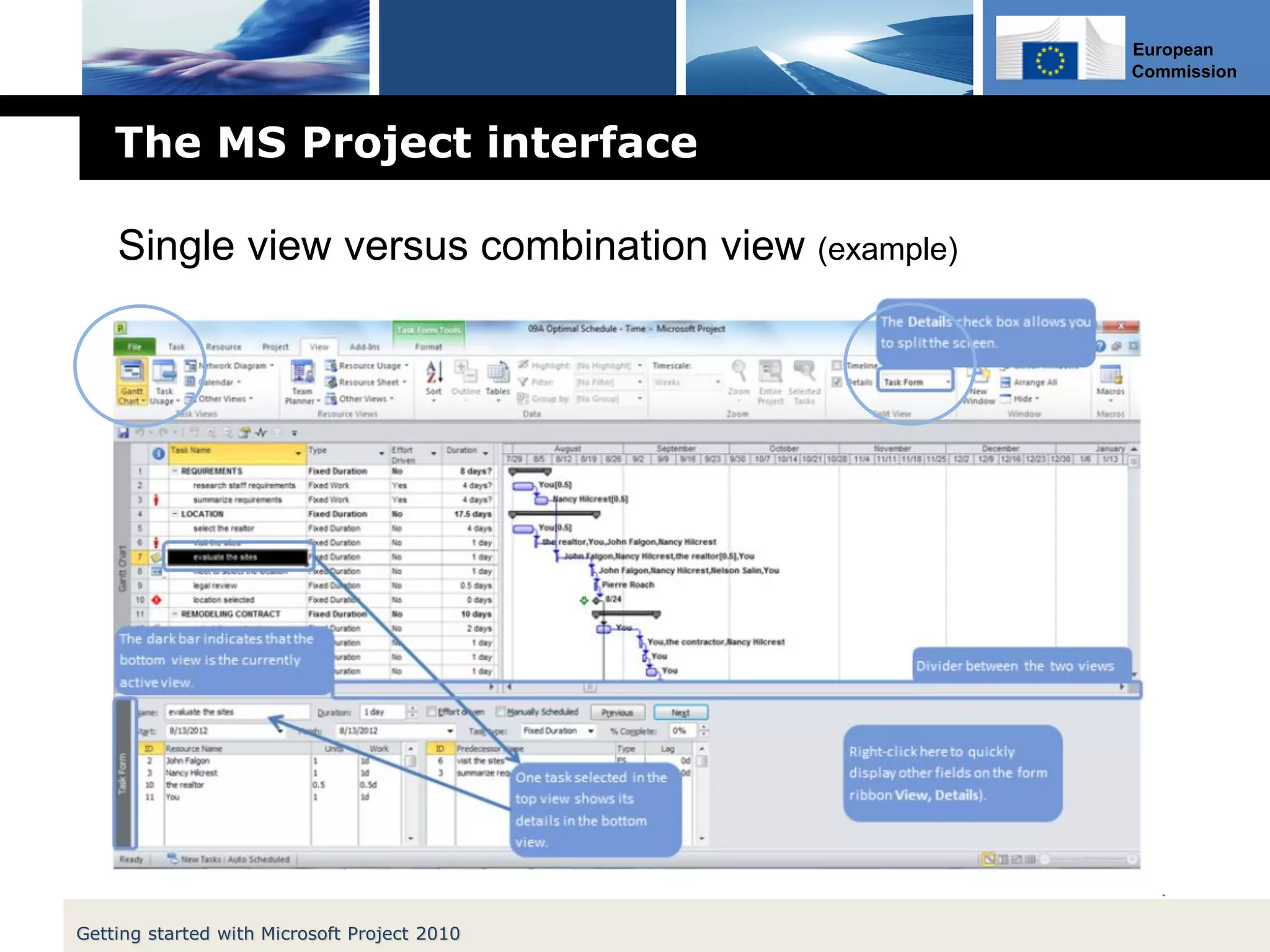

The MS Project interface

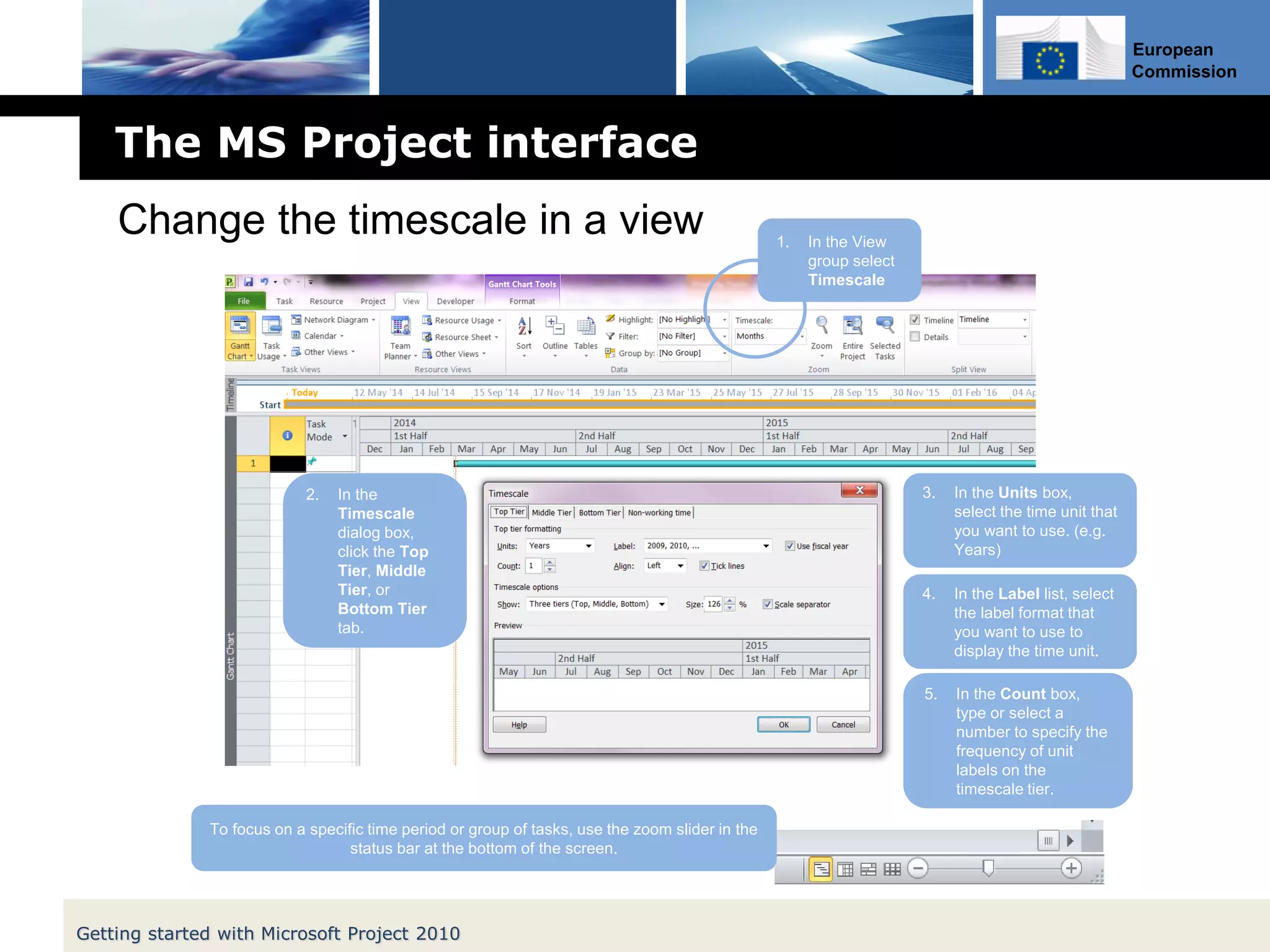

Getting started with Microsoft Project 2010
Change the timescale in a view 1. In the View
group select
Timescale
2. In the
Timescale
dialog box,
click the Top
Tier, Middle
Tier, or
Bottom Tier
tab.
3. In the Units box,
select the time unit that
you want to use. (e.g.
Years)
4. In the Label list, select
the label format that
you want to use to
display the time unit.
5. In the Count box,
type or select a
number to specify the
frequency of unit
labels on the
timescale tier.
To focus on a specific time period or group of tasks, use the zoom slider in the
status bar at the bottom of the screen.
11. European
Commission
Create a project: basic steps
Start a new project from a Start or Finish date
Add tasks, recurring tasks and milestones
Creating WBS with Summary Tasks
Create dependencies
Assign resources
Find critical path
Close Project
Getting started with Microsoft Project 2010
12. European
Commission
Create a project: basic steps
Start a new project from a Start or Finish date
Add tasks, recurring tasks and milestones
Creating WBS with Summary Tasks
Create dependencies
Assign resources
Close Project
Find critical path
Getting started with Microsoft Project 2010
13. European
Commission

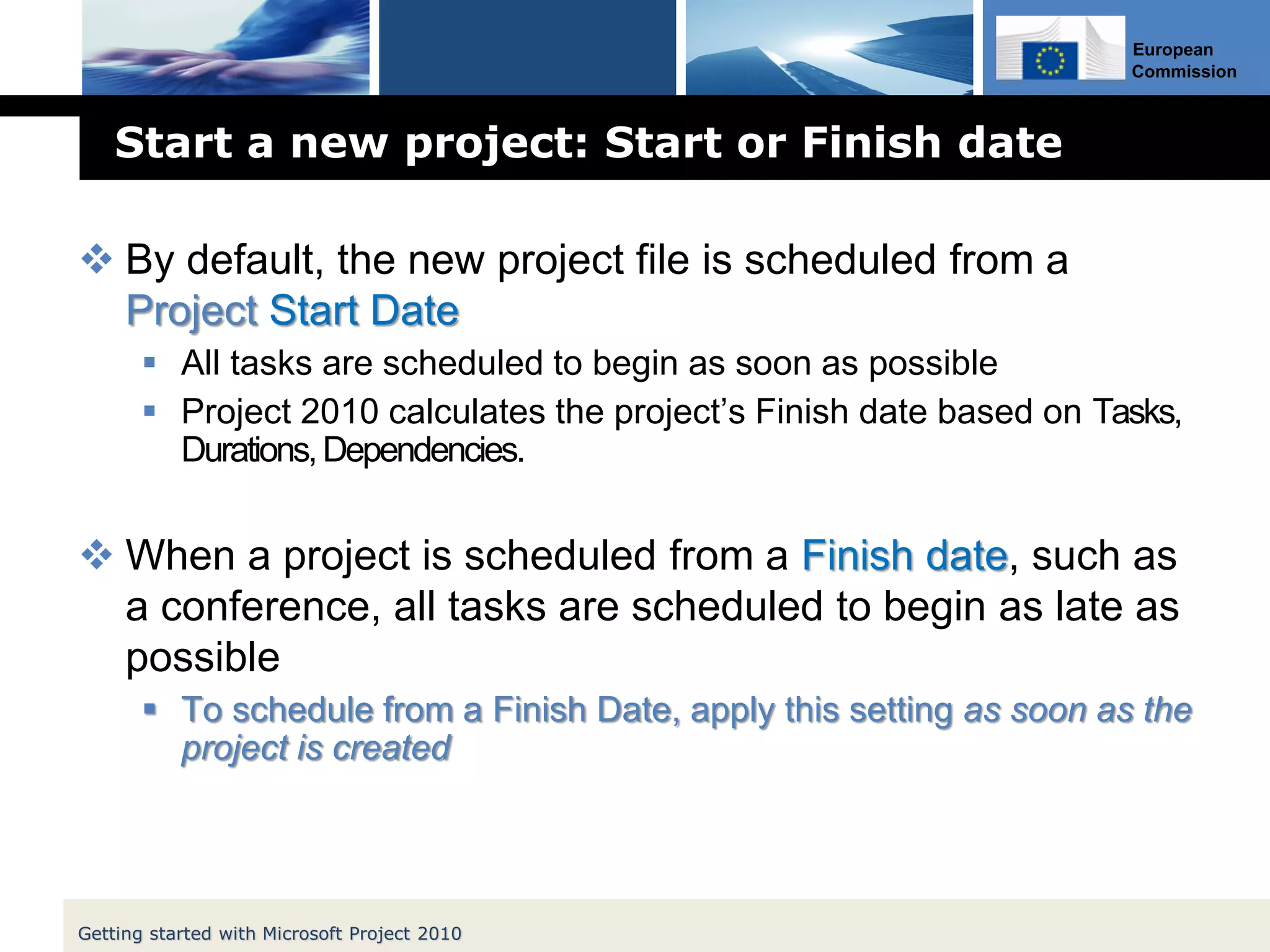

Start a new project: Start or Finish date
ï¶ By default, the new project file is scheduled from a
Project Start Date
ï§ All tasks are scheduled to begin as soon as possible
ï§ Project 2010 calculates the projectâs Finish date based on Tasks,
Durations,Dependencies.
ï¶ When a project is scheduled from a Finish date, such as
a conference, all tasks are scheduled to begin as late as
possible
ï§ To schedule from a Finish Date, apply this setting as soon as the
project is created
Getting started with Microsoft Project 2010

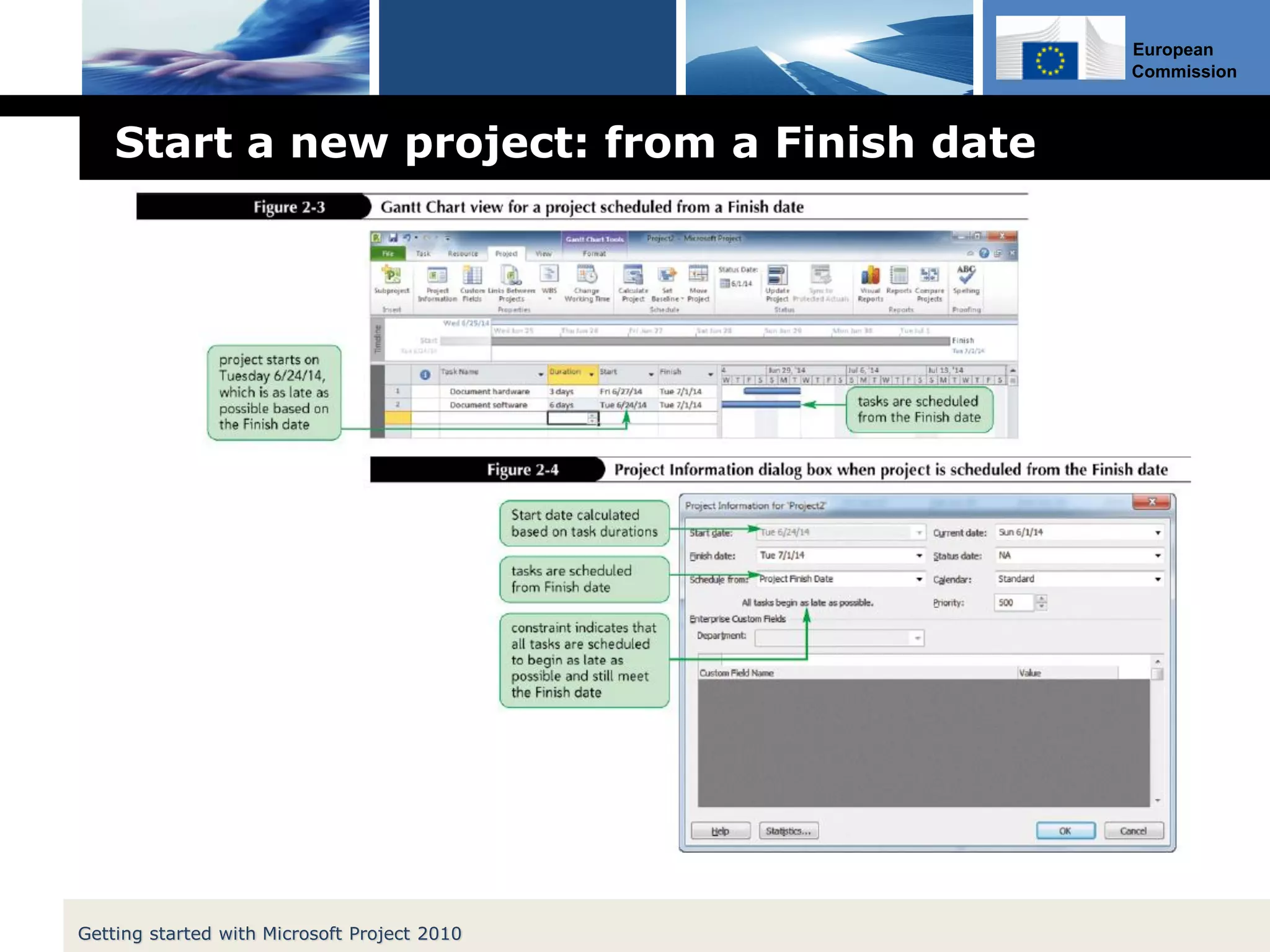

14. European
Commission

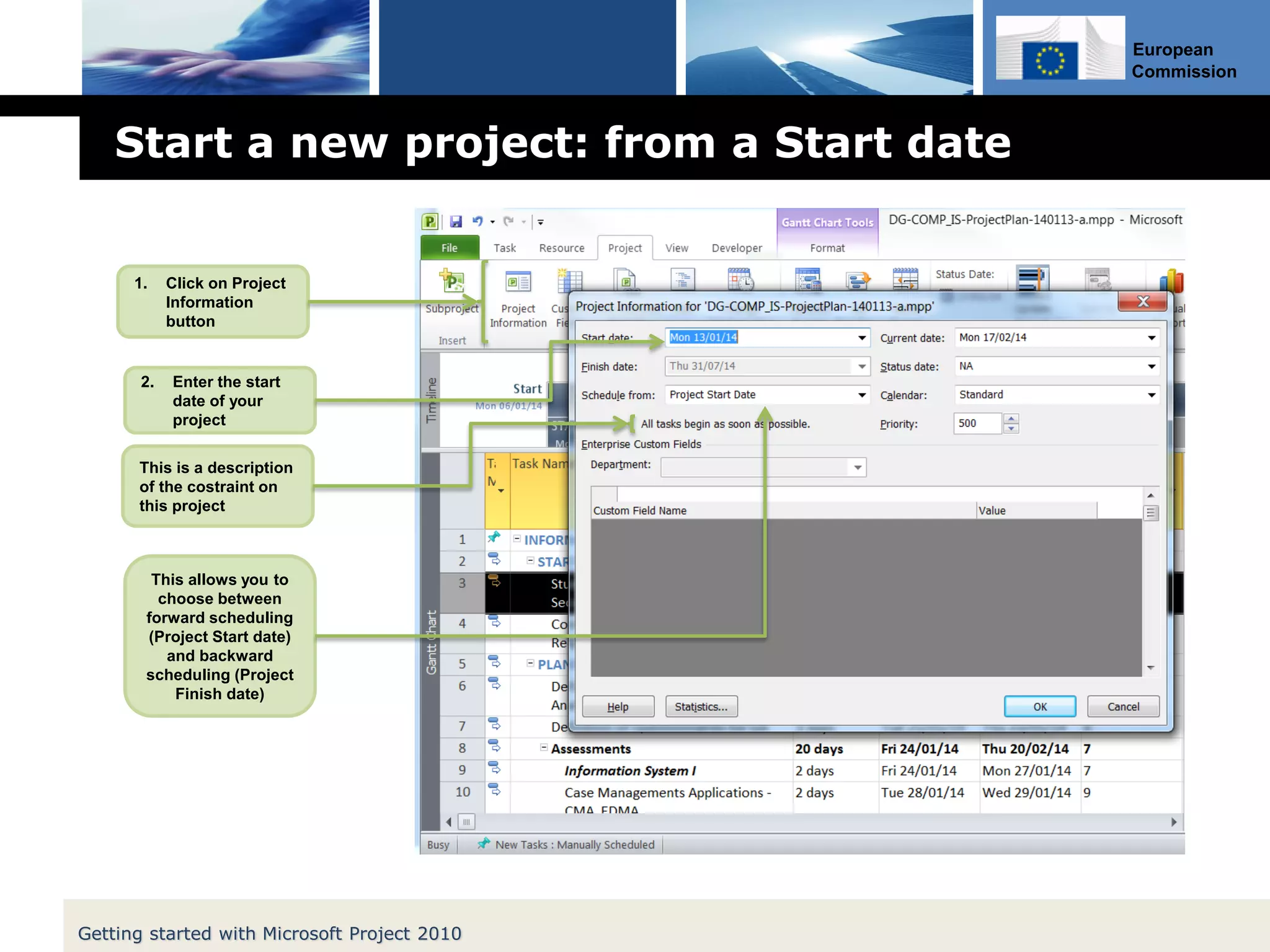

Start a new project: from a Start date
Getting started with Microsoft Project 2010
1. Click on Project
Information
button
2. Enter the start
date of your
project
This is a description
of the costraint on
this project
This allows you to
choose between
forward scheduling
(Project Start date)
and backward
scheduling (Project
Finish date)
16. European
Commission
Create a project: Customize standard calendar
ï¶ By default, the entire project, each task, and each resource is
scheduled according to the Standard calendar.
ï¶ The Standard calendar specifies that Monday through Friday
are working days with 8 hours of work completed each
day. Saturday and Sunday are designated as nonworking
days.
ï¶ The Calendar can be modified to identify holidays or other
nonworking days or times in which work should not be
scheduled.
ï¶ You can also create unique calendars for tasks and resources
that do not follow the working and nonworking times specified
by the Standard calendar.
Getting started with Microsoft Project 2010
17. European
Commission

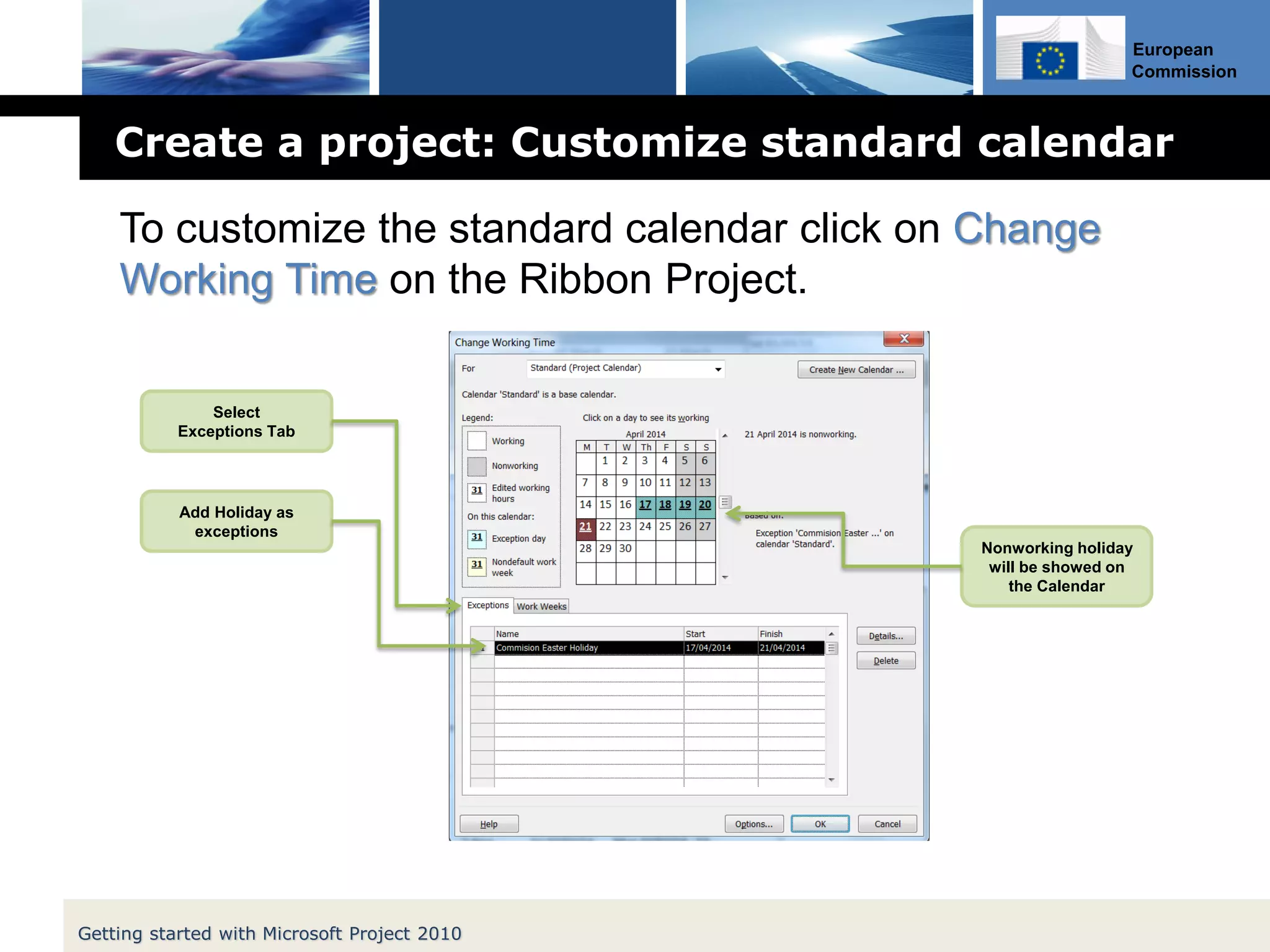

Create a project: Customize standard calendar
Getting started with Microsoft Project 2010
Select
Exceptions Tab
Add Holiday as
exceptions
Nonworking holiday
will be showed on
the Calendar
To customize the standard calendar click on Change
Working Time on the Ribbon Project.
18. European
Commission

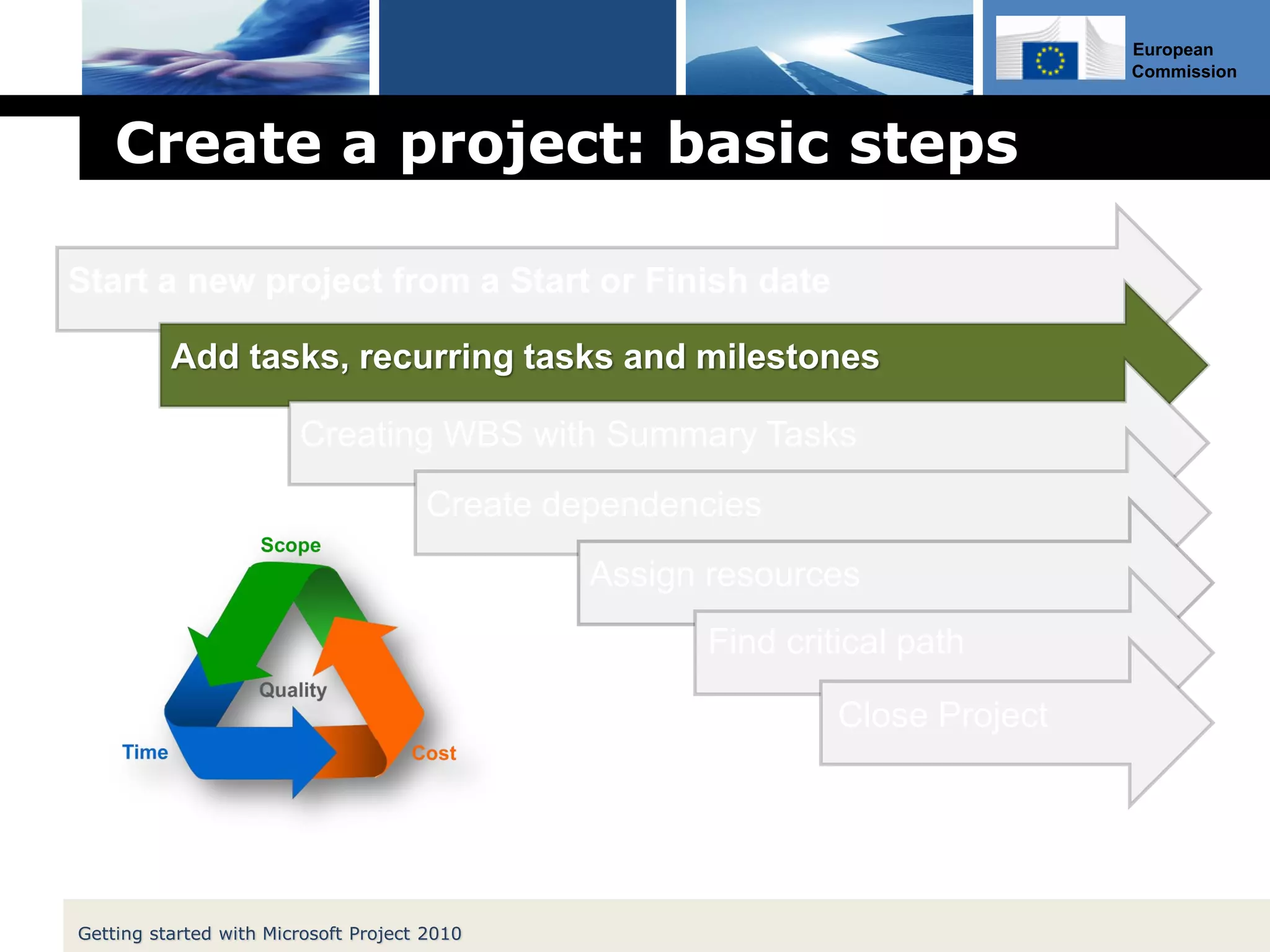

Create a project: basic steps
Start a new project from a Start or Finish date
Add tasks, recurring tasks and milestones
Creating WBS with Summary Tasks
Create dependencies
Assign resources
Close Project
Find critical path
Getting started with Microsoft Project 2010
19. European
Commission
Create a project: Entering tasks and durations
ï¶ Entering tasks and durations is probably the single
most important effort in developing a useful project file.
ï¶ If tasks are omitted or durations underestimated, the
value of the projectâs scheduling and cost information is
compromised.
ï¶ Often you will need to change an existing task or insert,
delete, split or move a task. Project 2010 offers a
variety of tools that you can use to accomplish these
common tasks.
Getting started with Microsoft Project 2010
20. European
Commission
Create a project: insert, delete, inactivate tasks
Getting started with Microsoft Project 2010
Rightâclick
shortcut
menus task
21. European
Commission

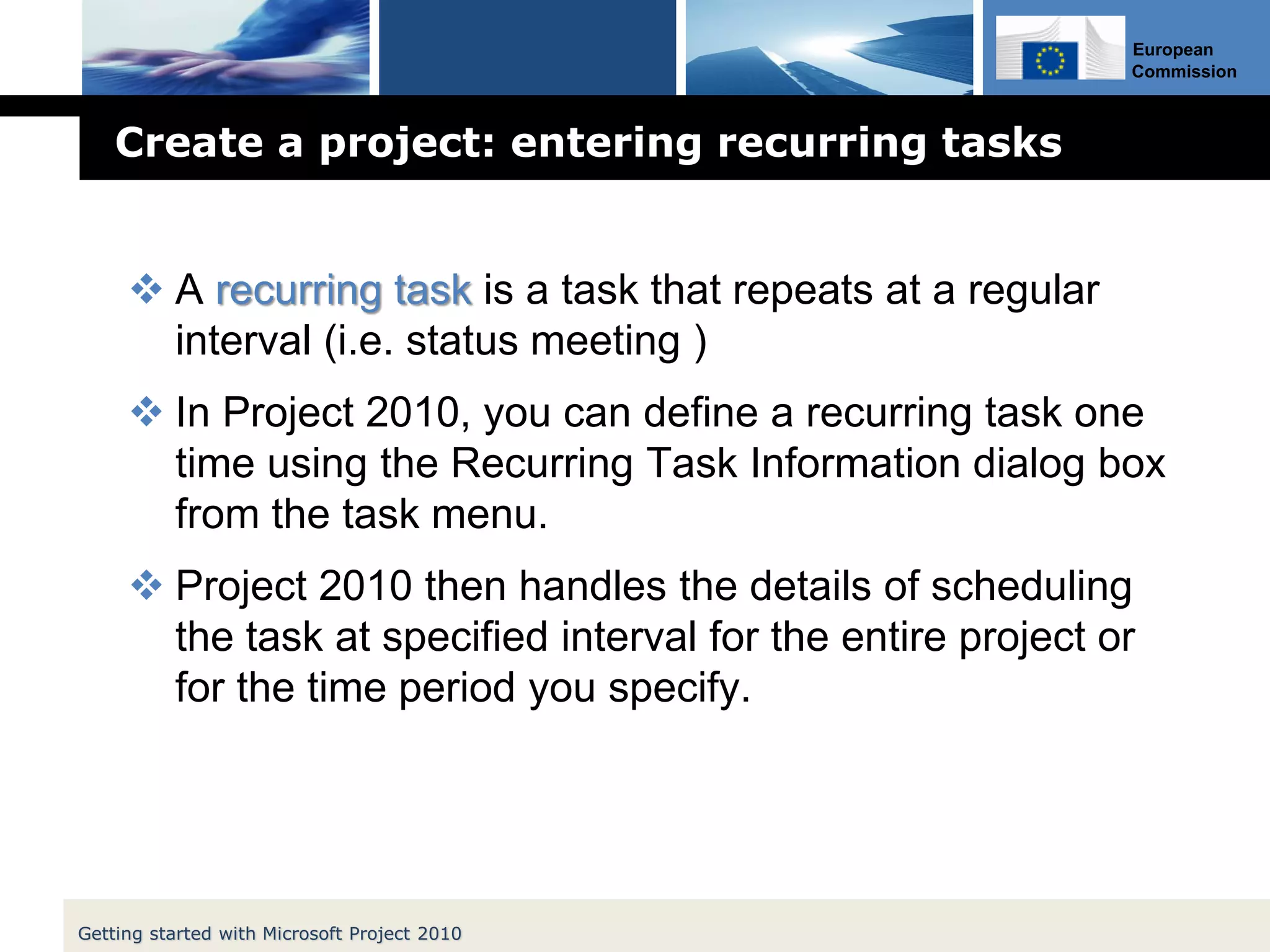

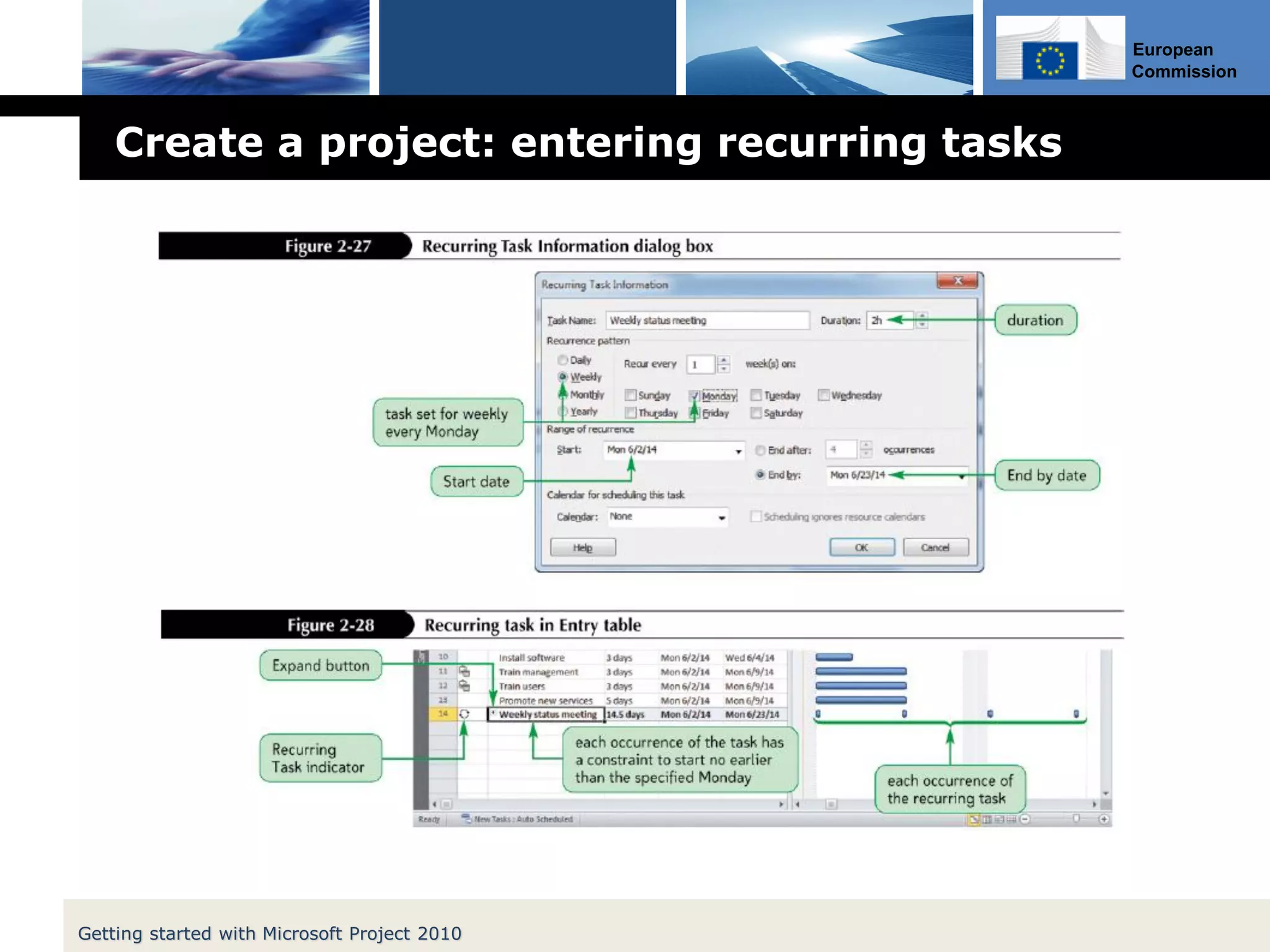

Create a project: entering recurring tasks
ï¶ A recurring task is a task that repeats at a regular
interval (i.e. status meeting )
ï¶ In Project 2010, you can define a recurring task one
time using the Recurring Task Information dialog box
from the task menu.
ï¶ Project 2010 then handles the details of scheduling
the task at specified interval for the entire project or
for the time period you specify.
Getting started with Microsoft Project 2010
23. European
Commission

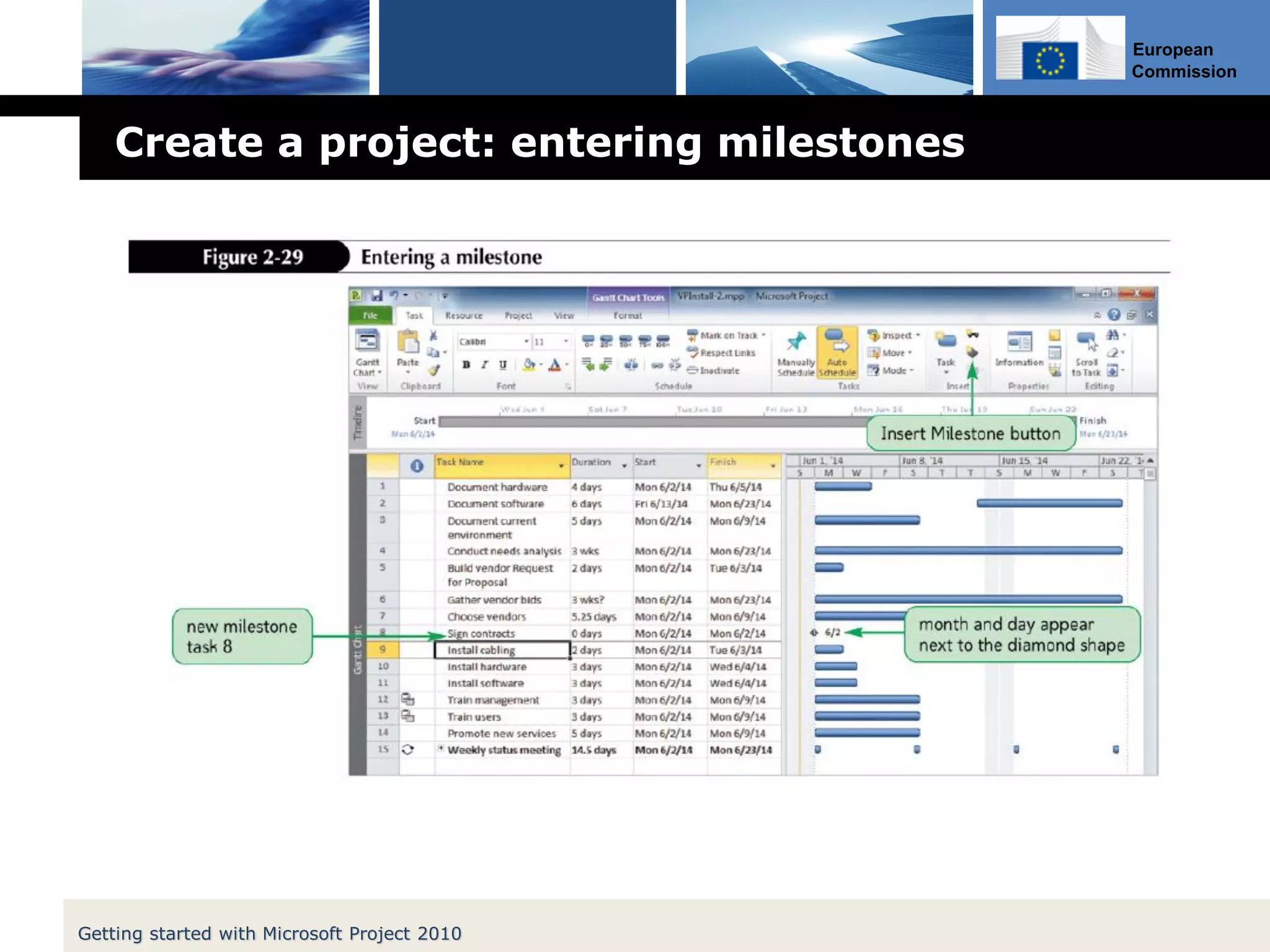

Create a project: entering milestones
ï¶ A milestone is a task that marks a significant point in
time or a progress checkpoint.
ï¶ It has a zero duration and is therefore a symbolic task
that is used mainly to communicate progress or to
mark the end of a significant phase of the project.
Examples include the signing of a contract or the
announcement of a new product.
ï¶ Milestones can also be used to motivate project
participants by recognizing accomplishments.
Getting started with Microsoft Project 2010
25. European
Commission

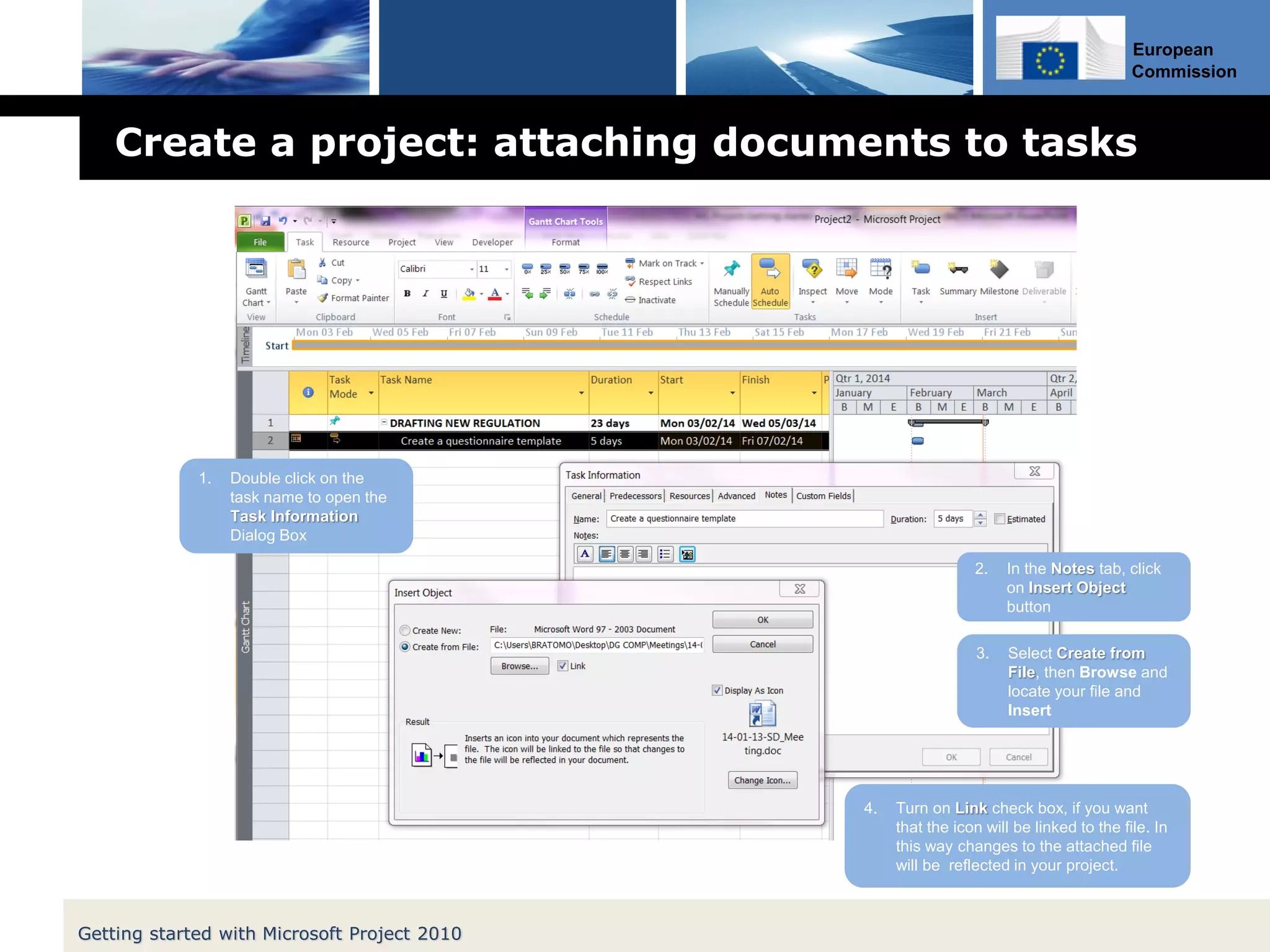

Create a project: attaching documents to tasks
Getting started with Microsoft Project 2010
1. Double click on the
task name to open the
Task Information
Dialog Box
2. In the Notes tab, click
on Insert Object
button
3. Select Create from
File, then Browse and
locate your file and
Insert
4. Turn on Link check box, if you want
that the icon will be linked to the file. In
this way changes to the attached file
will be reflected in your project.
26. European
Commission

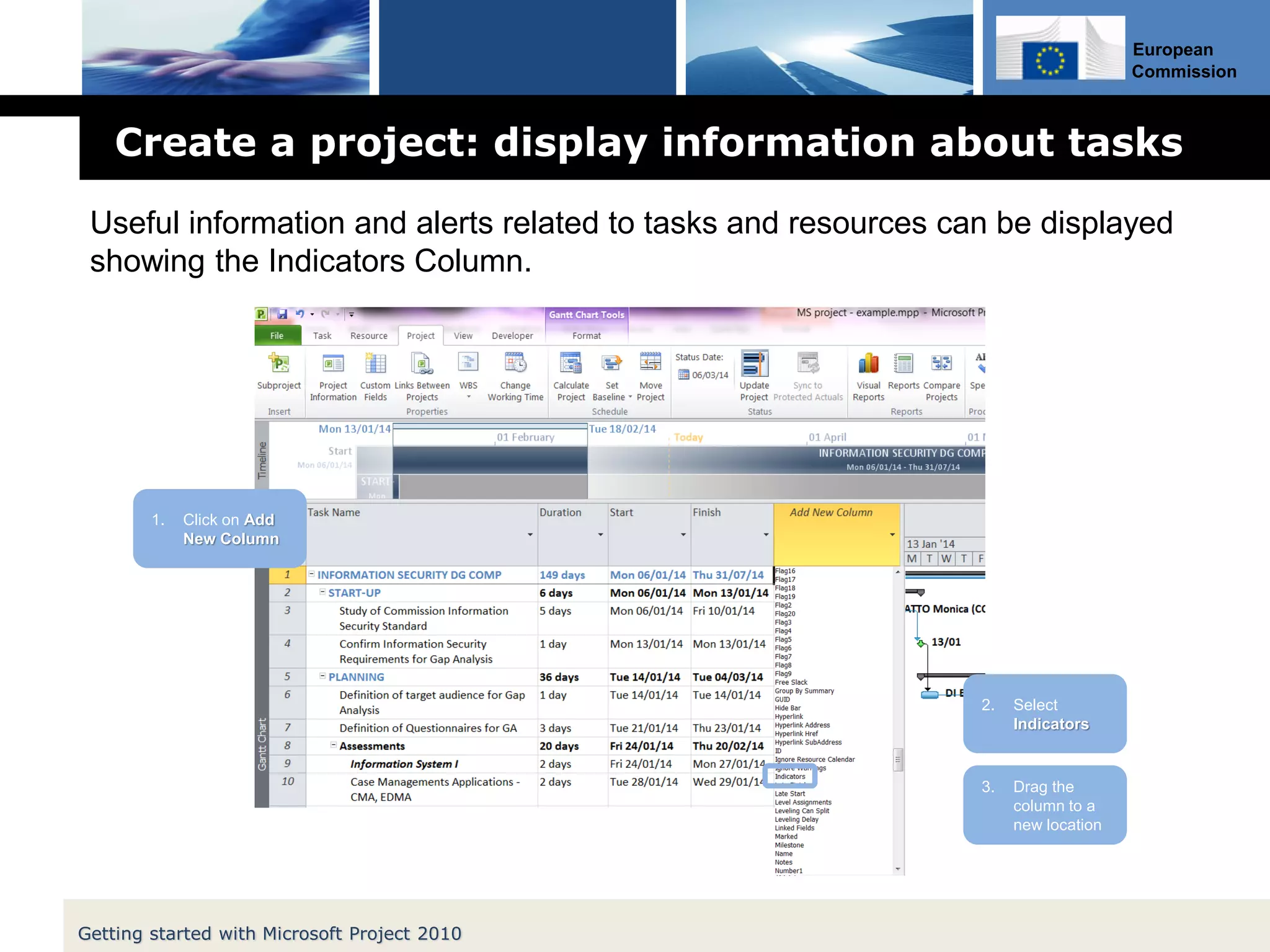

Create a project: display information about tasks
Getting started with Microsoft Project 2010
2. Select
Indicators
1. Click on Add
New Column
3. Drag the
column to a
new location
Useful information and alerts related to tasks and resources can be displayed
showing the Indicators Column.
27. European
Commission

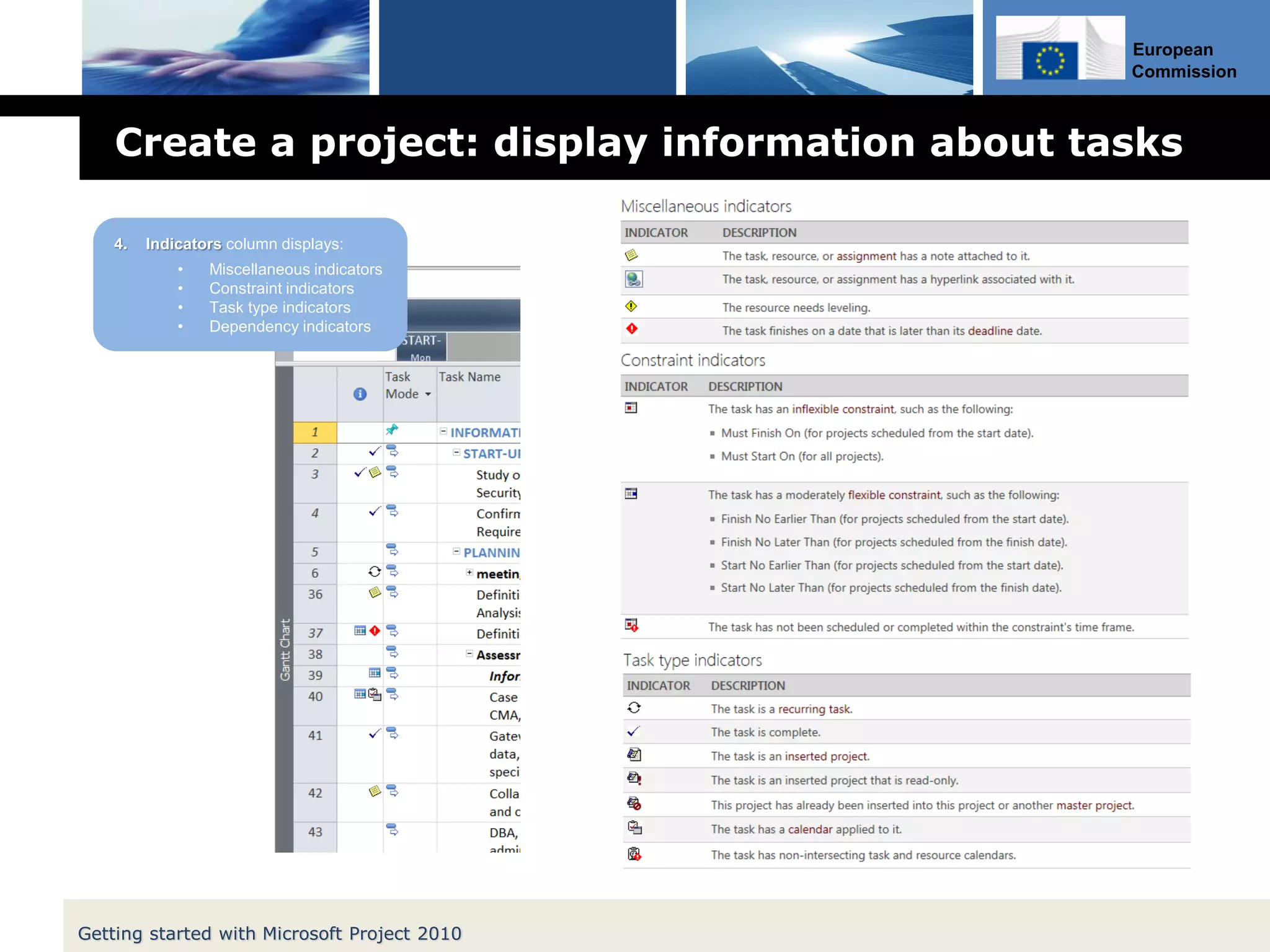

Create a project: display information about tasks
Getting started with Microsoft Project 2010
4. Indicators column displays:
âą Miscellaneous indicators
âą Constraint indicators
âą Task type indicators
âą Dependency indicators
28. European
Commission

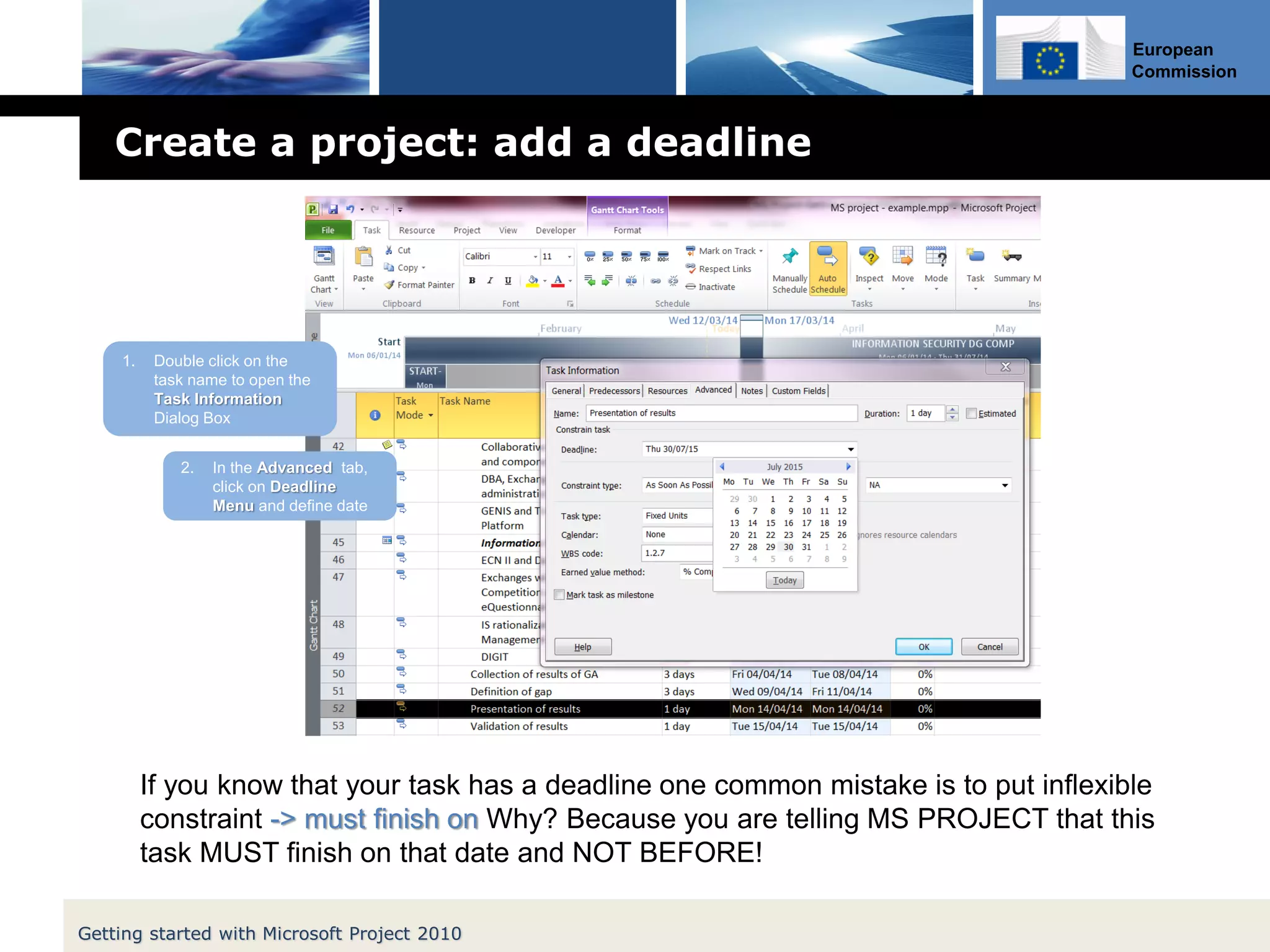

Create a project: add a deadline
Getting started with Microsoft Project 2010
1. Double click on the
task name to open the
Task Information
Dialog Box
2. In the Advanced tab,
click on Deadline
Menu and define date
If you know that your task has a deadline one common mistake is to put inflexible
constraint -> must finish on Why? Because you are telling MS PROJECT that this
task MUST finish on that date and NOT BEFORE!
29. European
Commission
Create a project: basic steps
Start a new project from a Start or Finish date
Add tasks, recurring tasks and milestones
Creating WBS with Summary Tasks
Create dependencies
Assign resources
Close Project
Find critical path
Getting started with Microsoft Project 2010
30. European
Commission

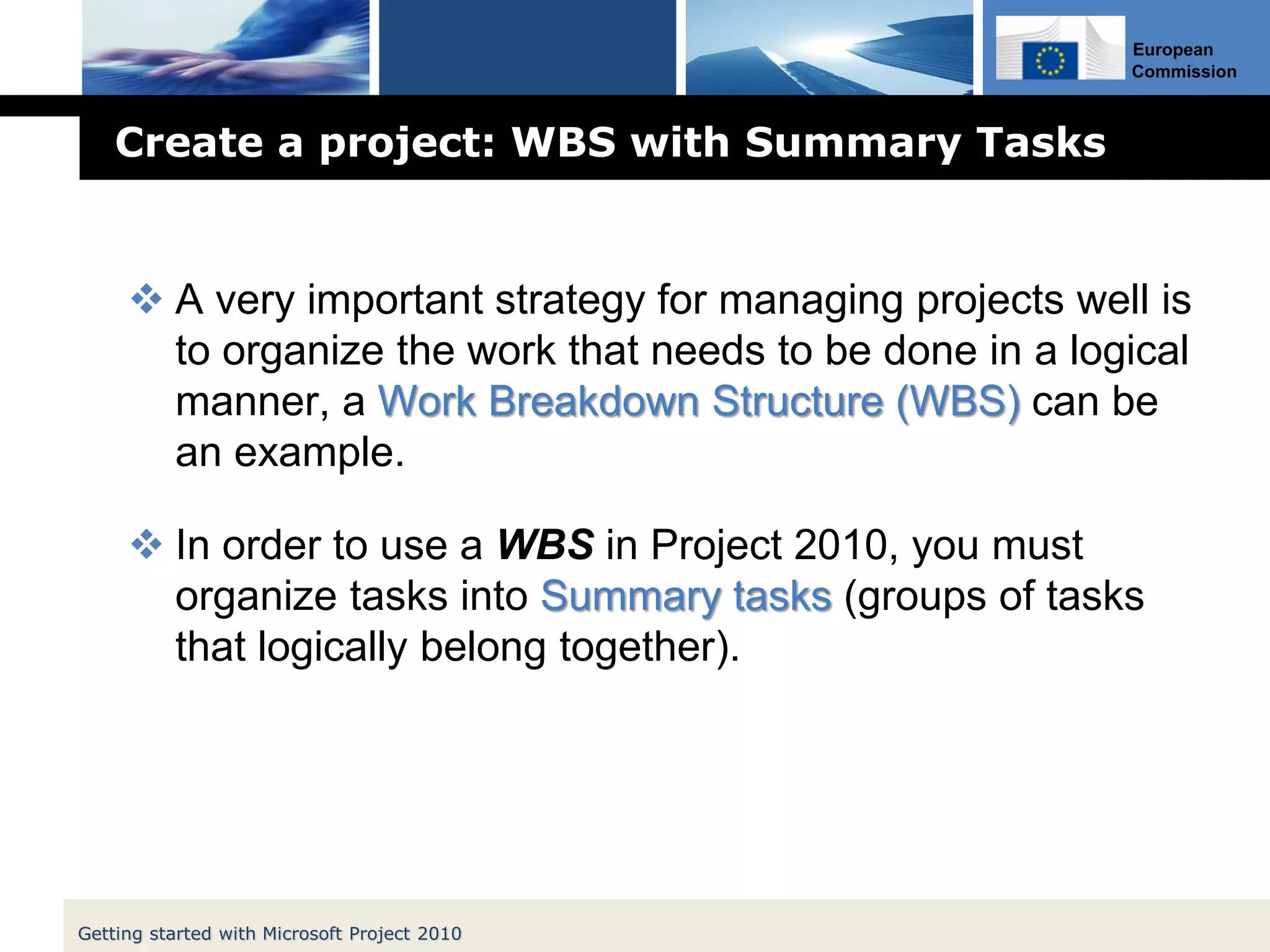

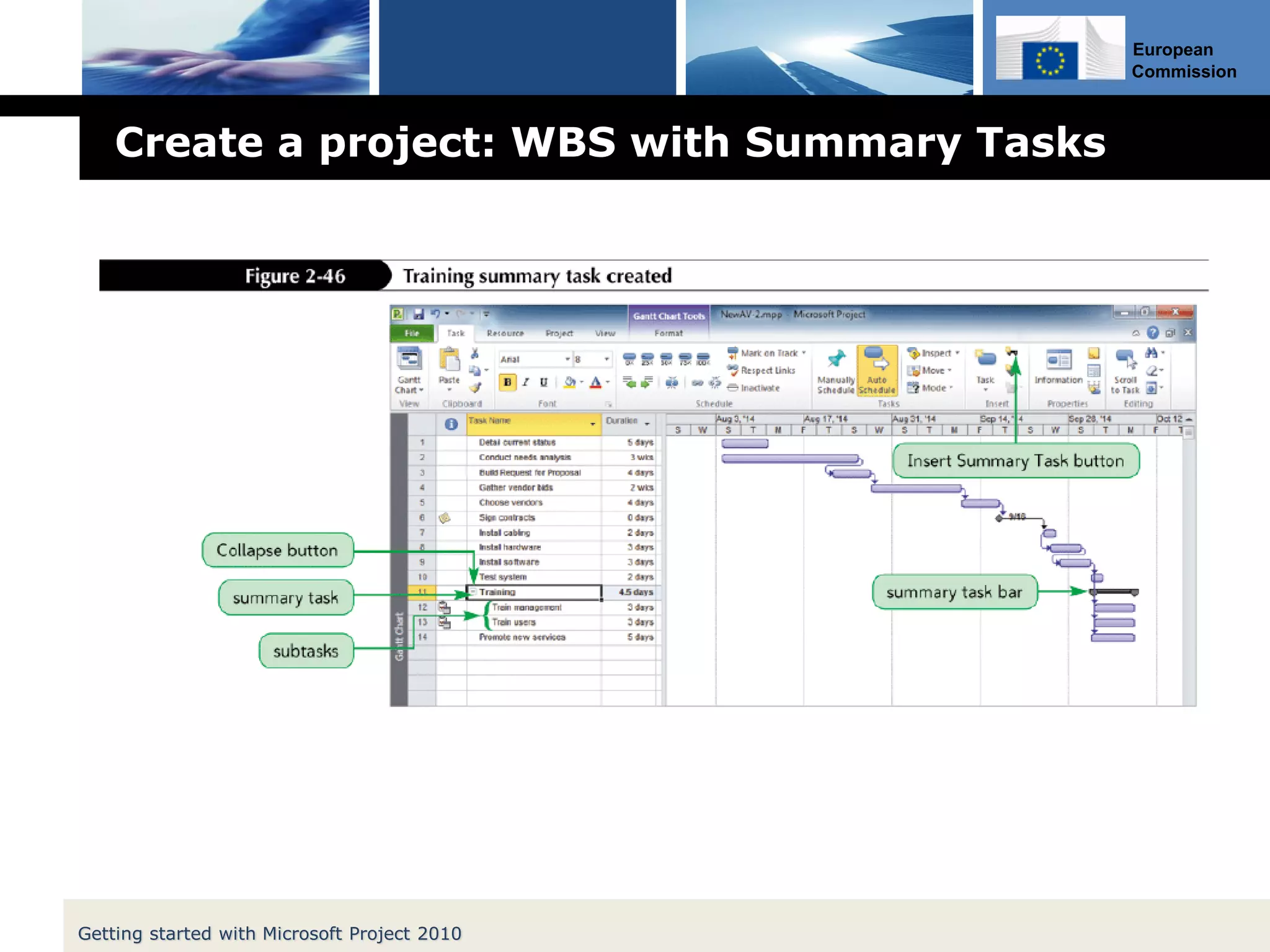

Create a project: WBS with Summary Tasks
ï¶ A very important strategy for managing projects well is
to organize the work that needs to be done in a logical
manner, a Work Breakdown Structure (WBS) can be
an example.
ï¶ In order to use a WBS in Project 2010, you must
organize tasks into Summary tasks (groups of tasks
that logically belong together).
Getting started with Microsoft Project 2010
31. European
Commission

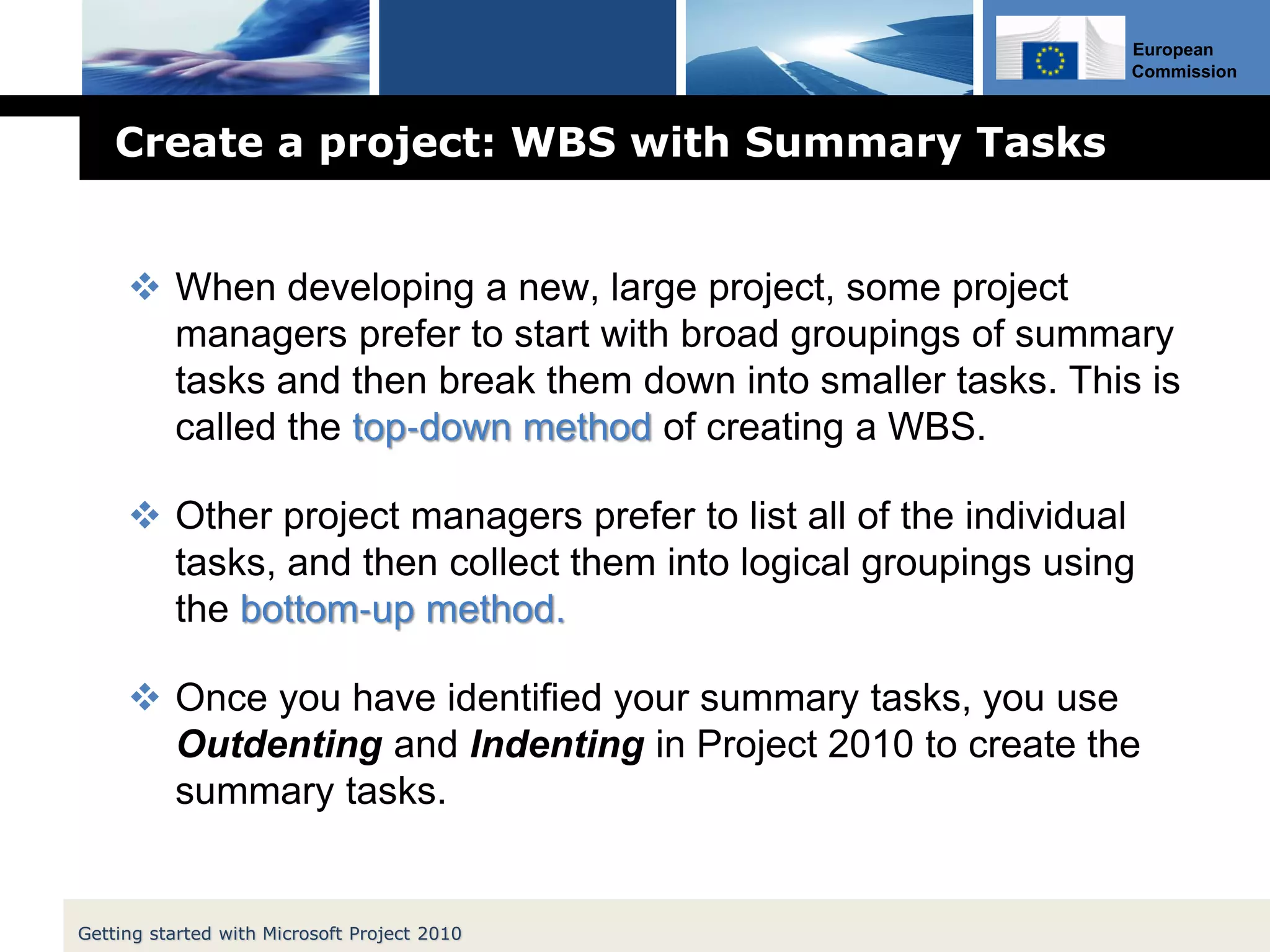

Create a project: WBS with Summary Tasks
ï¶ When developing a new, large project, some project
managers prefer to start with broad groupings of summary
tasks and then break them down into smaller tasks. This is
called the topâdown method of creating a WBS.
ï¶ Other project managers prefer to list all of the individual
tasks, and then collect them into logical groupings using
the bottomâup method.
ï¶ Once you have identified your summary tasks, you use
Outdenting and Indenting in Project 2010 to create the
summary tasks.
Getting started with Microsoft Project 2010
33. European
Commission
Create a project: basic steps
Start a new project from a Start or Finish date
Add tasks, recurring tasks and milestones
Creating WBS with Summary Tasks
Create dependencies
Assign resources
Close Project
Find critical path
Getting started with Microsoft Project 2010
34. European
Commission

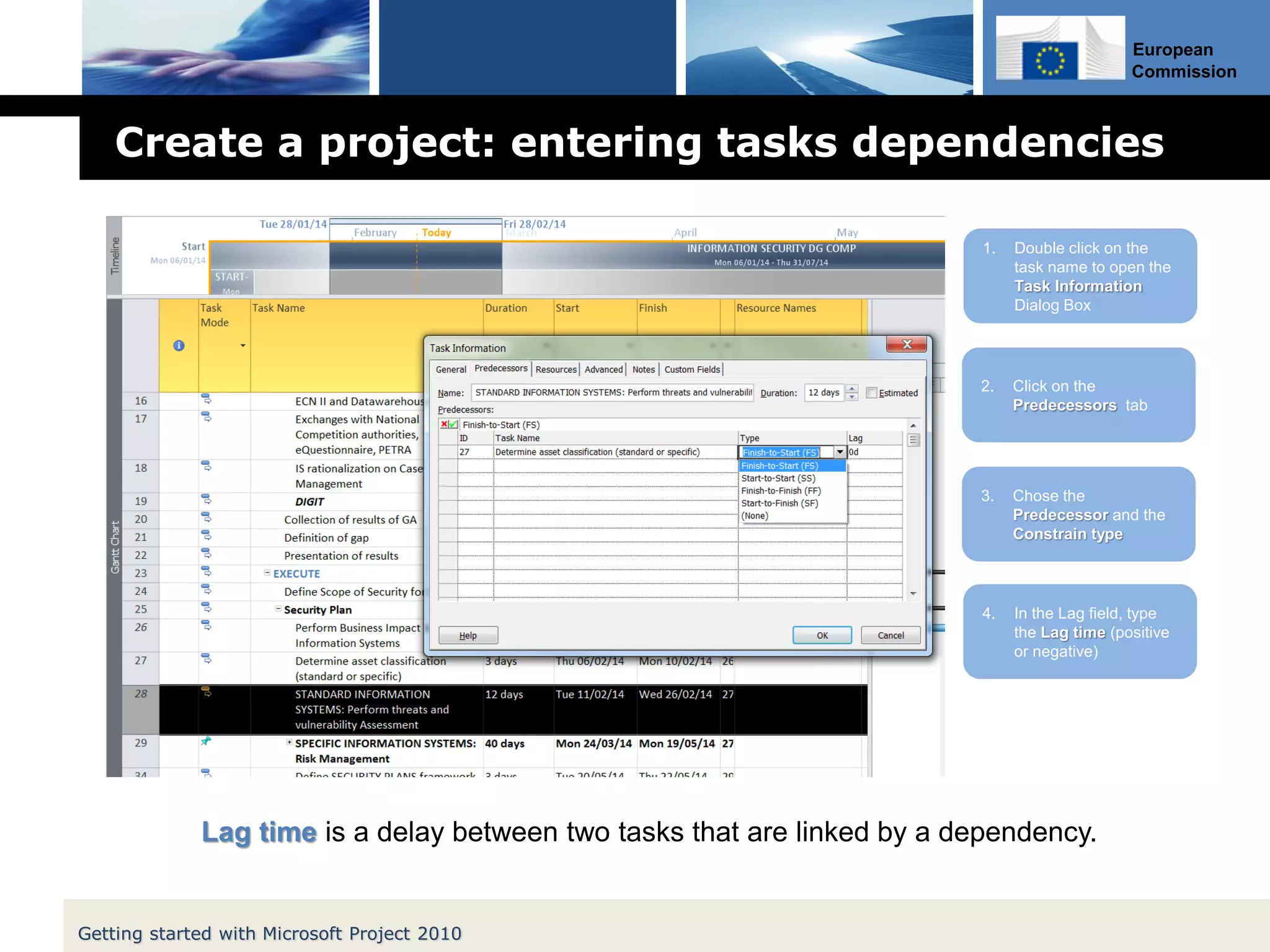

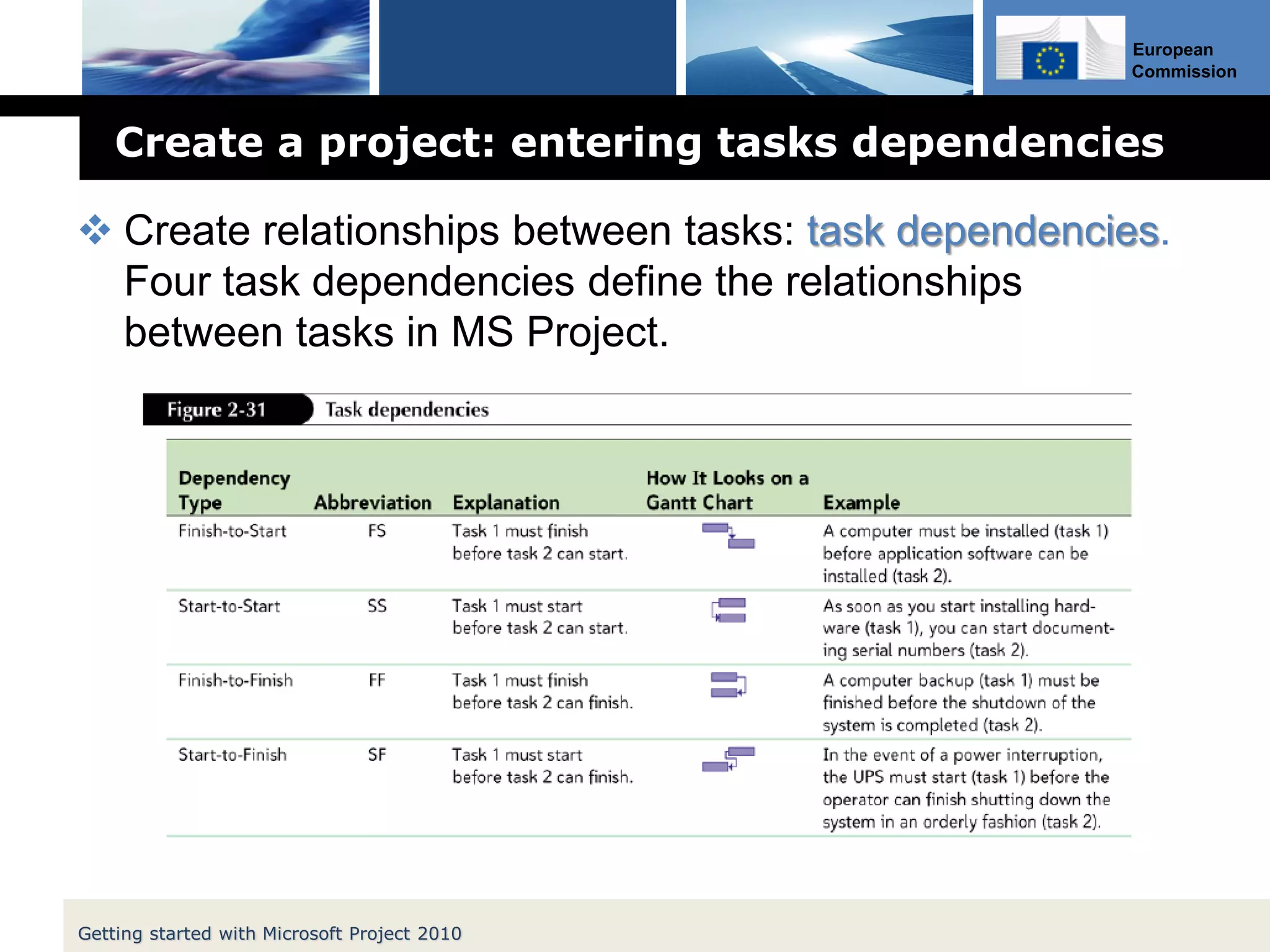

Create a project: entering tasks dependencies
ï¶ Create relationships between tasks: task dependencies.
Four task dependencies define the relationships
between tasks in MS Project.
Getting started with Microsoft Project 2010
35. European
Commission
Create a project: entering tasks dependencies
Getting started with Microsoft Project 2010
1. Double click on the
task name to open the
Task Information
Dialog Box
2. Click on the
Predecessors tab
3. Chose the
Predecessor and the
Constrain type
4. In the Lag field, type
the Lag time (positive
or negative)
Lag time is a delay between two tasks that are linked by a dependency.
36. European
Commission
Create a project: entering tasks dependencies
Getting started with Microsoft Project 2010
Create task dependencies using the predecessors column.
2. Select
Predecessors
1. Click on Add
New Column
3. Digit the ID of the
task you want to
link.
37. European
Commission
Create a project: basic steps
Start a new project from a Start or Finish date
Add tasks, recurring tasks and milestones
Creating WBS with Summary Tasks
Create dependencies
Assign resources
Close Project
Find critical path
Getting started with Microsoft Project 2010
38. European
Commission

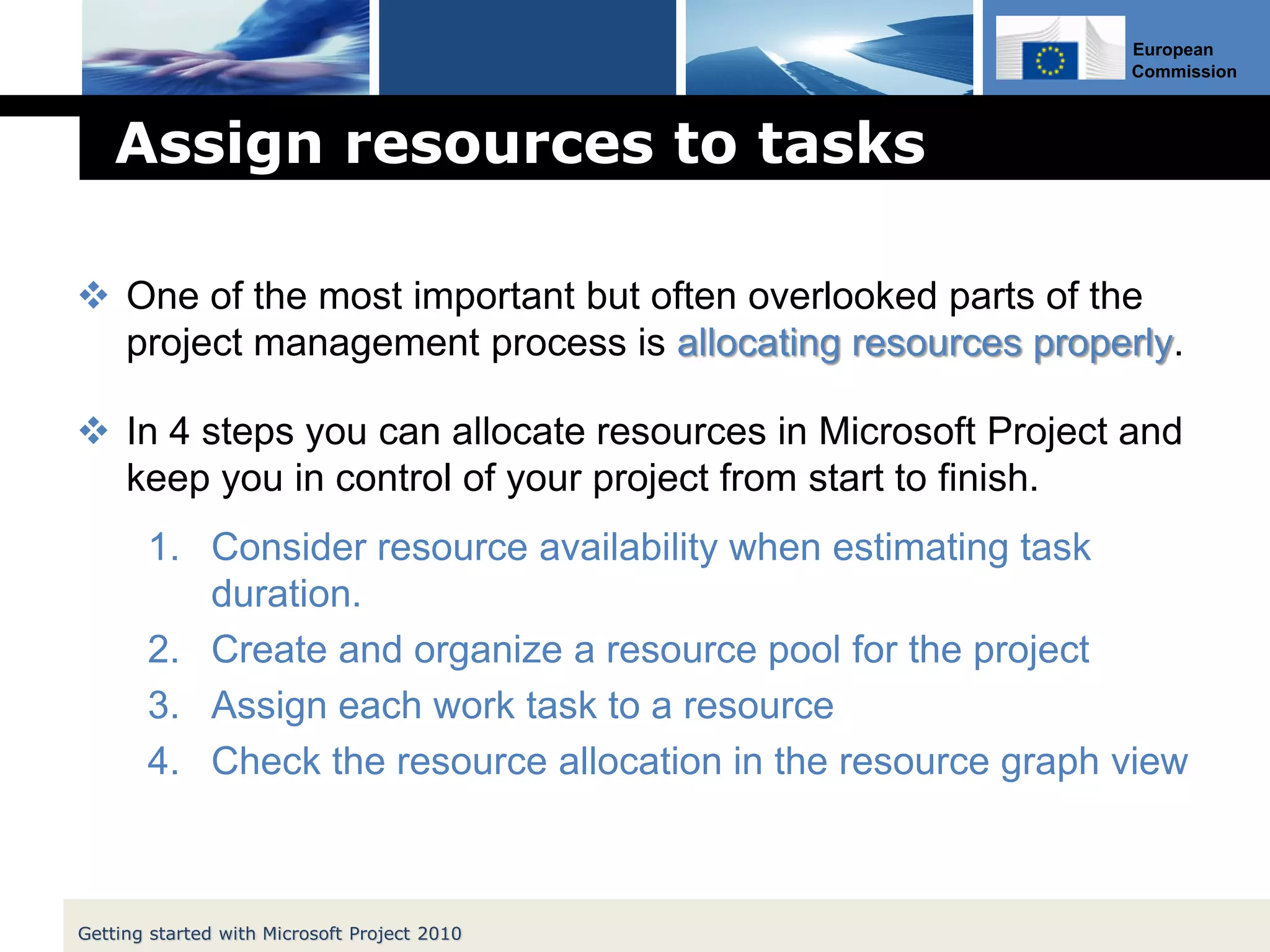

Assign resources to tasks
ï¶ One of the most important but often overlooked parts of the
project management process is allocating resources properly.
ï¶ In 4 steps you can allocate resources in Microsoft Project and
keep you in control of your project from start to finish.
1. Consider resource availability when estimating task
duration.
2. Create and organize a resource pool for the project
3. Assign each work task to a resource
4. Check the resource allocation in the resource graph view
Getting started with Microsoft Project 2010
39. European
Commission

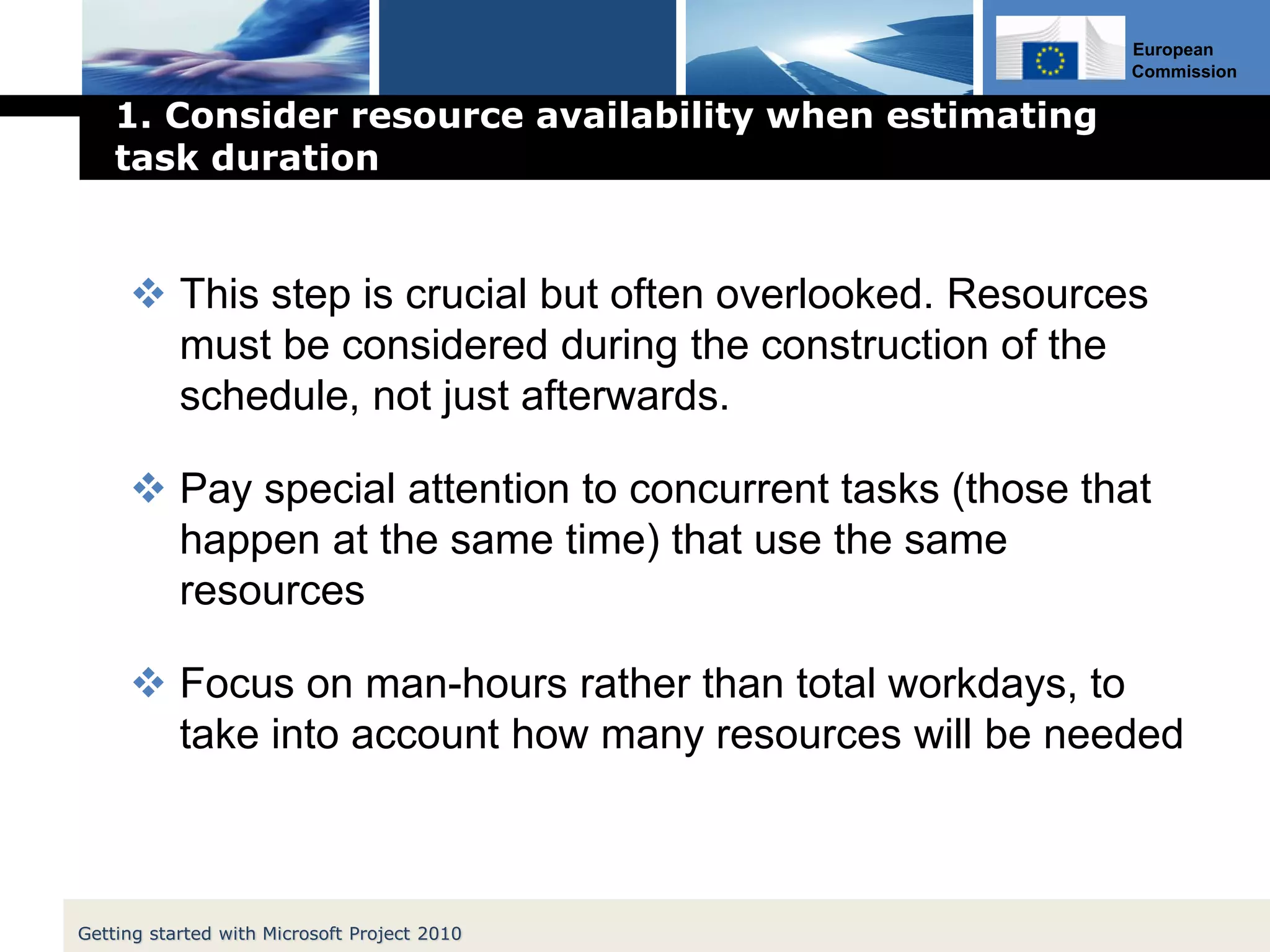

1. Consider resource availability when estimating
task duration
ï¶ This step is crucial but often overlooked. Resources
must be considered during the construction of the
schedule, not just afterwards.
ï¶ Pay special attention to concurrent tasks (those that
happen at the same time) that use the same
resources
ï¶ Focus on man-hours rather than total workdays, to
take into account how many resources will be needed
Getting started with Microsoft Project 2010
40. European
Commission
2. Create and organize a resource pool for the project
ï§ On the View menu, click Resource
Sheet
ï§ On the Resource menu, click Add
Resources
ï§ Define which kind of resource you
need:
âą "Work" resources are the most
useful, and should be used to
categorize
âą "Material" resources should refer
to materials that get used up
during work,
âą "Cost" resources are time
independent resources (like
Airplane tickets)
Getting started with Microsoft Project 2010
41. European
Commission

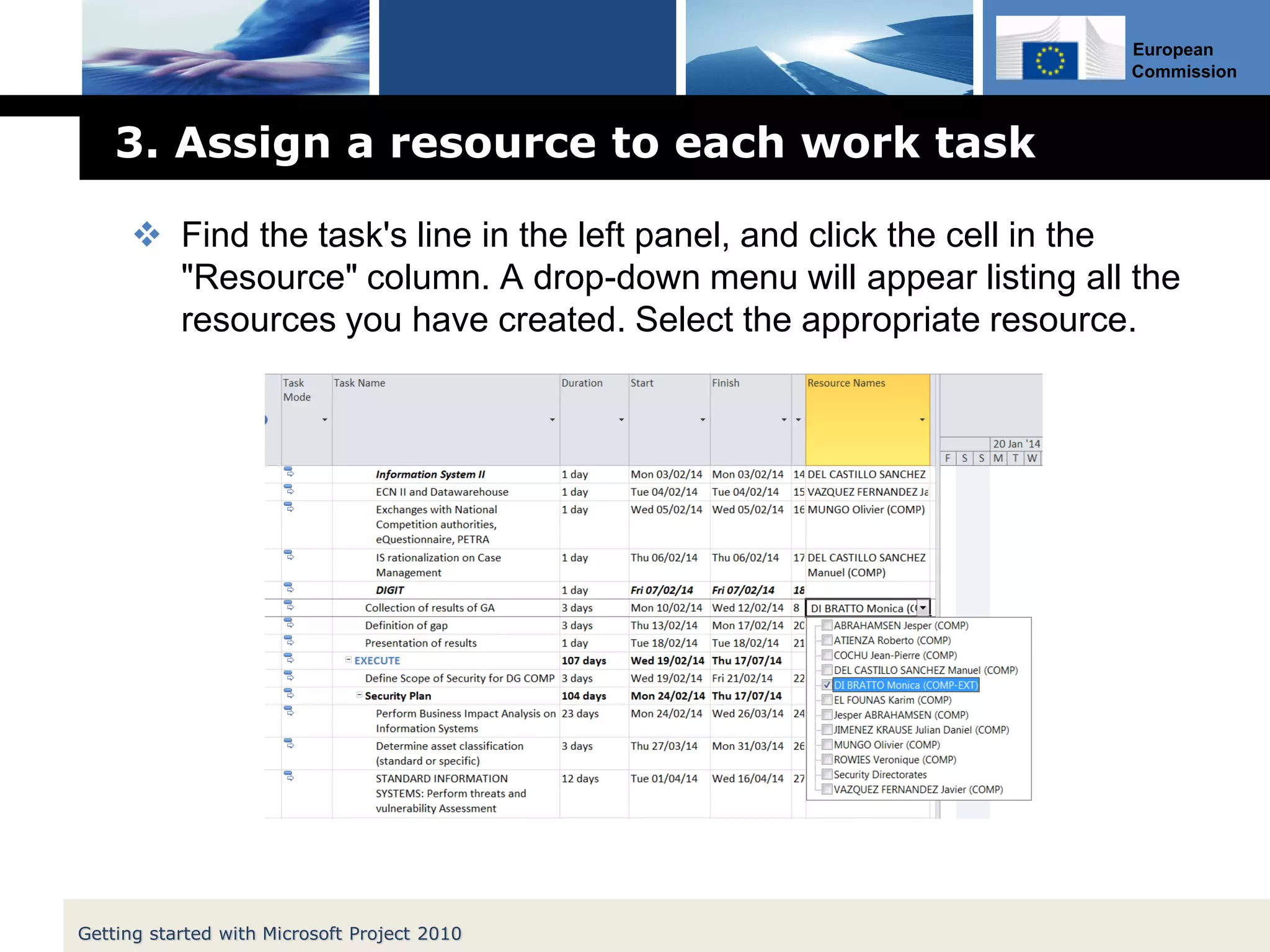

3. Assign a resource to each work task
ï¶ Find the task's line in the left panel, and click the cell in the
"Resource" column. A drop-down menu will appear listing all the
resources you have created. Select the appropriate resource.
Getting started with Microsoft Project 2010
42. European
Commission

4. Check the resource allocation in the resource
graph view
ï¶ After creating your schedule and assigning resources, you
can check for over-allocation (click on "View" and select
"Resource Graph")
ï¶ Any point at which a resource exceeds 100 percent usage
represents an over-allocation (meaning the resource can't
possibly perform all the tasks assigned to it in the given
time). Over-allocation is represented in red.
ï¶ To remedy this, increase the task durations, assign more
resources to the tasks, or shift concurrent tasks to create
less overlap.
Getting started with Microsoft Project 2010
43. European
Commission

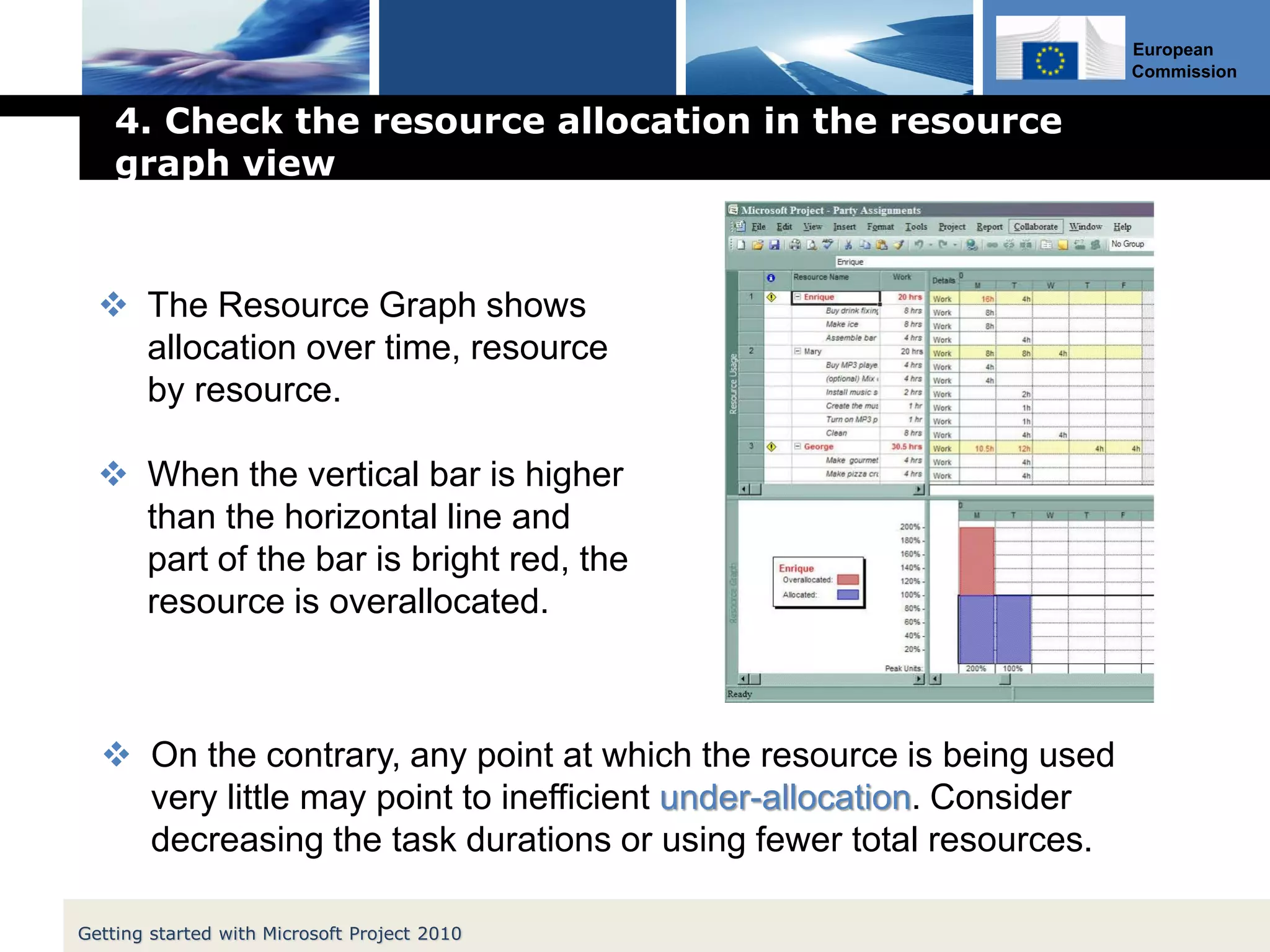

4. Check the resource allocation in the resource
graph view
ï¶ On the contrary, any point at which the resource is being used
very little may point to inefficient under-allocation. Consider
decreasing the task durations or using fewer total resources.
ï¶ The Resource Graph shows
allocation over time, resource
by resource.
ï¶ When the vertical bar is higher
than the horizontal line and
part of the bar is bright red, the
resource is overallocated.
Getting started with Microsoft Project 2010
44. European
Commission
Create a project: basic steps
Start a new project from a Start or Finish date
Add tasks, recurring tasks and milestones
Creating WBS with Summary Tasks
Create dependencies
Assign resources
Close Project
Find critical path
Getting started with Microsoft Project 2010
45. European
Commission
Find critical path
ï¶ Critical path: the series of critical tasks that dictates the
calculated finish date of the project in Project path.
ï¶ Critical tasks: the tasks that cannot be delayed without
affecting the project finish date. A task becomes critical
when it meets any one of the following conditions:
ï§ It has no slack.
ï§ It has a Must Start On (MSO) or Must Finish On (MFO) date
constraint.
ï§ It has an As Late As Possible (ALAP) constraint in a project
scheduled from a start date.
ï§ It has an As Soon As Possible (ASAP) constraint in a project
scheduled from a finish date.
Getting started with Microsoft Project 2010
46. European
Commission

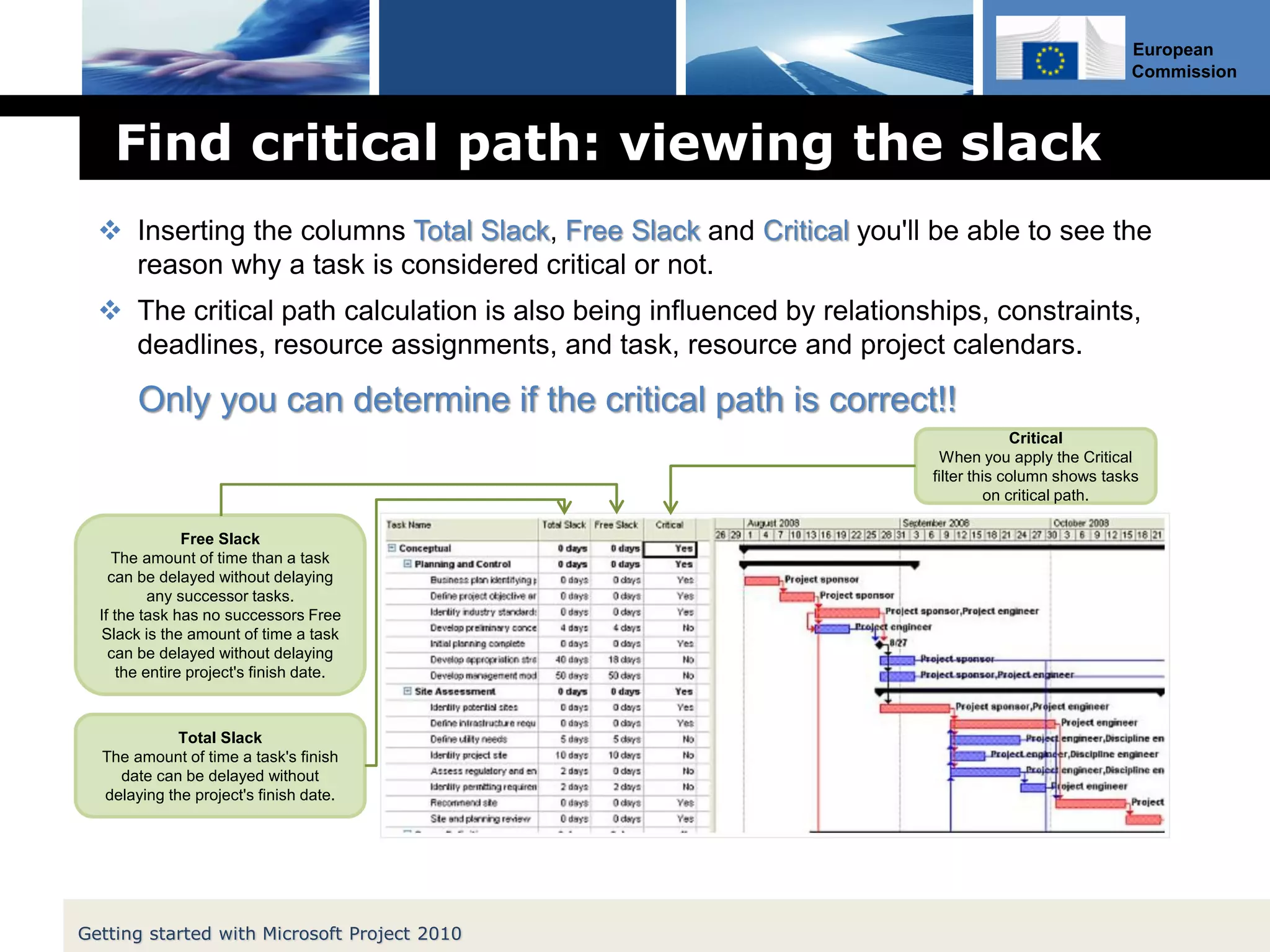

Find critical path: viewing the slack
ï¶ Inserting the columns Total Slack, Free Slack and Critical you'll be able to see the
reason why a task is considered critical or not.
ï¶ The critical path calculation is also being influenced by relationships, constraints,
deadlines, resource assignments, and task, resource and project calendars.
Only you can determine if the critical path is correct!!
Total Slack
The amount of time a task's finish
date can be delayed without
delaying the project's finish date.
Free Slack
The amount of time than a task
can be delayed without delaying
any successor tasks.
If the task has no successors Free
Slack is the amount of time a task
can be delayed without delaying
the entire project's finish date.
Critical
When you apply the Critical
filter this column shows tasks
on critical path.
Getting started with Microsoft Project 2010
47. European
Commission

Find critical path: crash your project
ï¶ If you want to bring in the project finish date, you need to bring in the
dates of your critical path tasks. This is also known as crashing a
project.
ï¶ Crash: To decrease a project's overall duration without changing
task relationships. Crashing a project typically requires assigning
additional resources to tasks.
To crash a project you can:
ï§ Shorten the duration or work on a task on the critical path.
ï§ Change a task constraint to allow for more scheduling flexibility.
ï§ Break a critical task into smaller tasks that can be worked on simultaneously by different
resources.
ï§ Revise task dependencies to allow more scheduling flexibility.
ï§ Set lead time between dependent tasks where applicable.
ï§ Schedule overtime.
ï§ Assign additional resources to work on critical path tasks.
Getting started with Microsoft Project 2010
48. European
Commission
Create a project: basic steps
Start a new project from a Start or Finish date
Add tasks, recurring tasks and milestones
Creating WBS with Summary Tasks
Create dependencies
Assign resources
Close Project
Find critical path
Getting started with Microsoft Project 2010
49. European
Commission

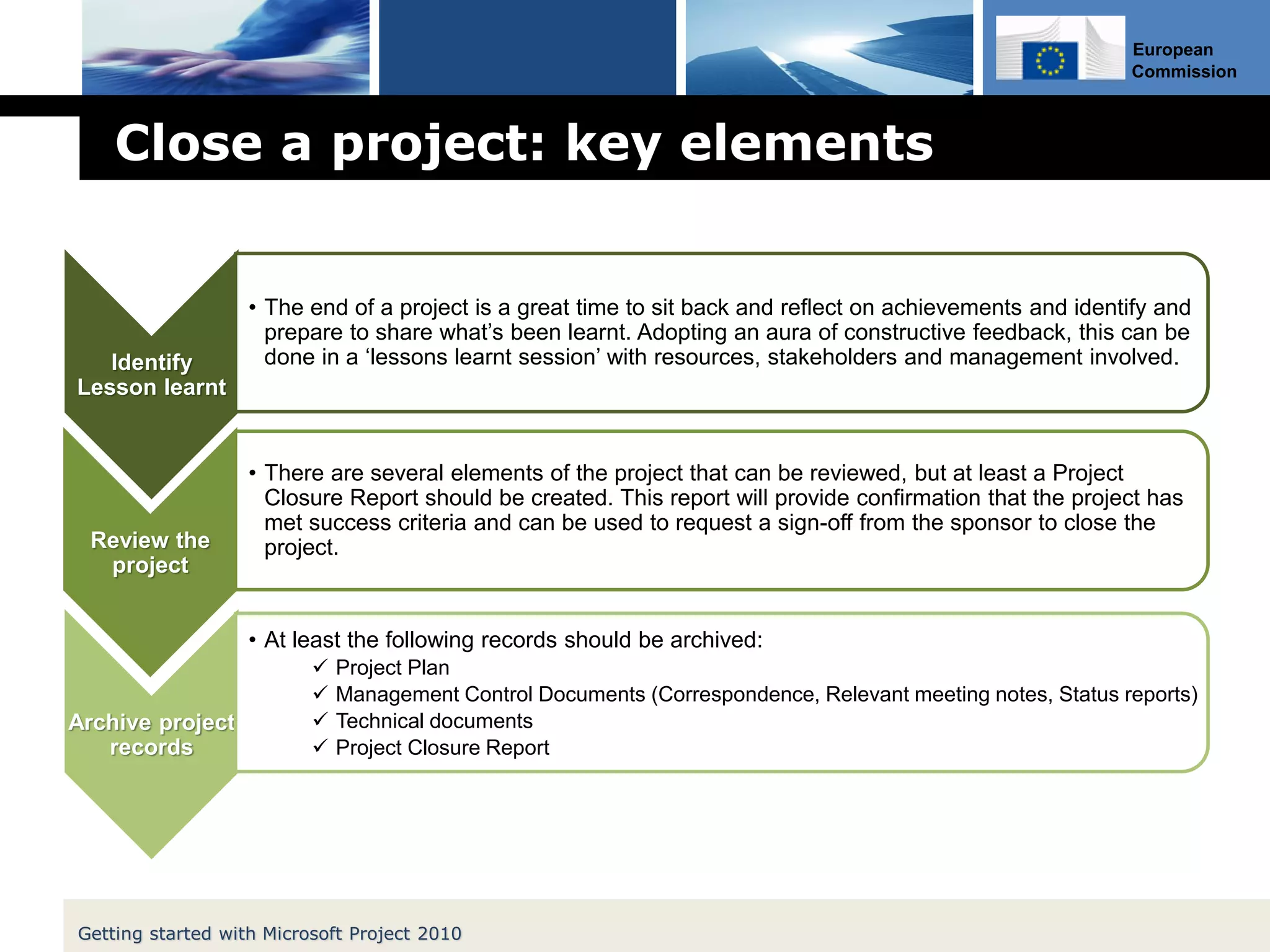

Close a project: key elements
Identify
Lesson learnt
âą The end of a project is a great time to sit back and reflect on achievements and identify and
prepare to share whatâs been learnt. Adopting an aura of constructive feedback, this can be
done in a âlessons learnt sessionâ with resources, stakeholders and management involved.
Review the
project
âą There are several elements of the project that can be reviewed, but at least a Project
Closure Report should be created. This report will provide confirmation that the project has
met success criteria and can be used to request a sign-off from the sponsor to close the
project.
Archive project
records
âą At least the following records should be archived:
ïŒ Project Plan
ïŒ Management Control Documents (Correspondence, Relevant meeting notes, Status reports)
ïŒ Technical documents
ïŒ Project Closure Report
Getting started with Microsoft Project 2010
52. European
Commission

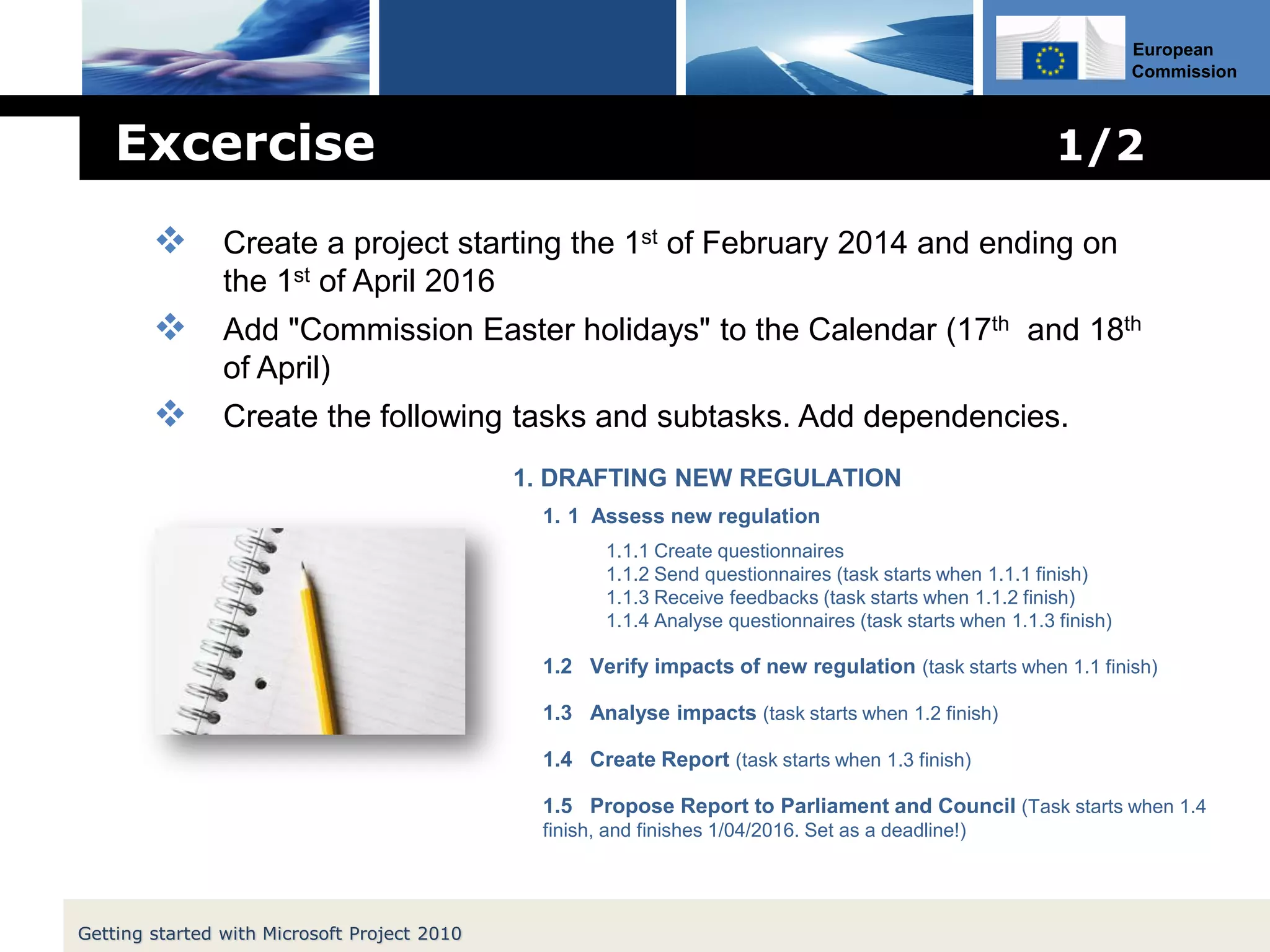

Excercise 1/2
1. DRAFTING NEW REGULATION
1. 1 Assess new regulation
1.1.1 Create questionnaires
1.1.2 Send questionnaires (task starts when 1.1.1 finish)
1.1.3 Receive feedbacks (task starts when 1.1.2 finish)
1.1.4 Analyse questionnaires (task starts when 1.1.3 finish)
1.2 Verify impacts of new regulation (task starts when 1.1 finish)
1.3 Analyse impacts (task starts when 1.2 finish)
1.4 Create Report (task starts when 1.3 finish)
1.5 Propose Report to Parliament and Council (Task starts when 1.4
finish, and finishes 1/04/2016. Set as a deadline!)
Getting started with Microsoft Project 2010
ï¶ Create a project starting the 1st of February 2014 and ending on
the 1st of April 2016
ï¶ Add "Commission Easter holidays" to the Calendar (17th and 18th
of April)
ï¶ Create the following tasks and subtasks. Add dependencies.
53. European
Commission
ï§ Add a "Weekly Team meeting"
recurring every Wednesday
until the end of the project
ï§ Attach a document to the first
meeting
ï§ Create a resource pool with
your names
ï§ Assign resources to tasks
ï§ Set the timescale to view the
entire project in the Gantt
Chart
Excercise 2/2
Getting started with Microsoft Project 2010
55. European
Commission
Recommendations

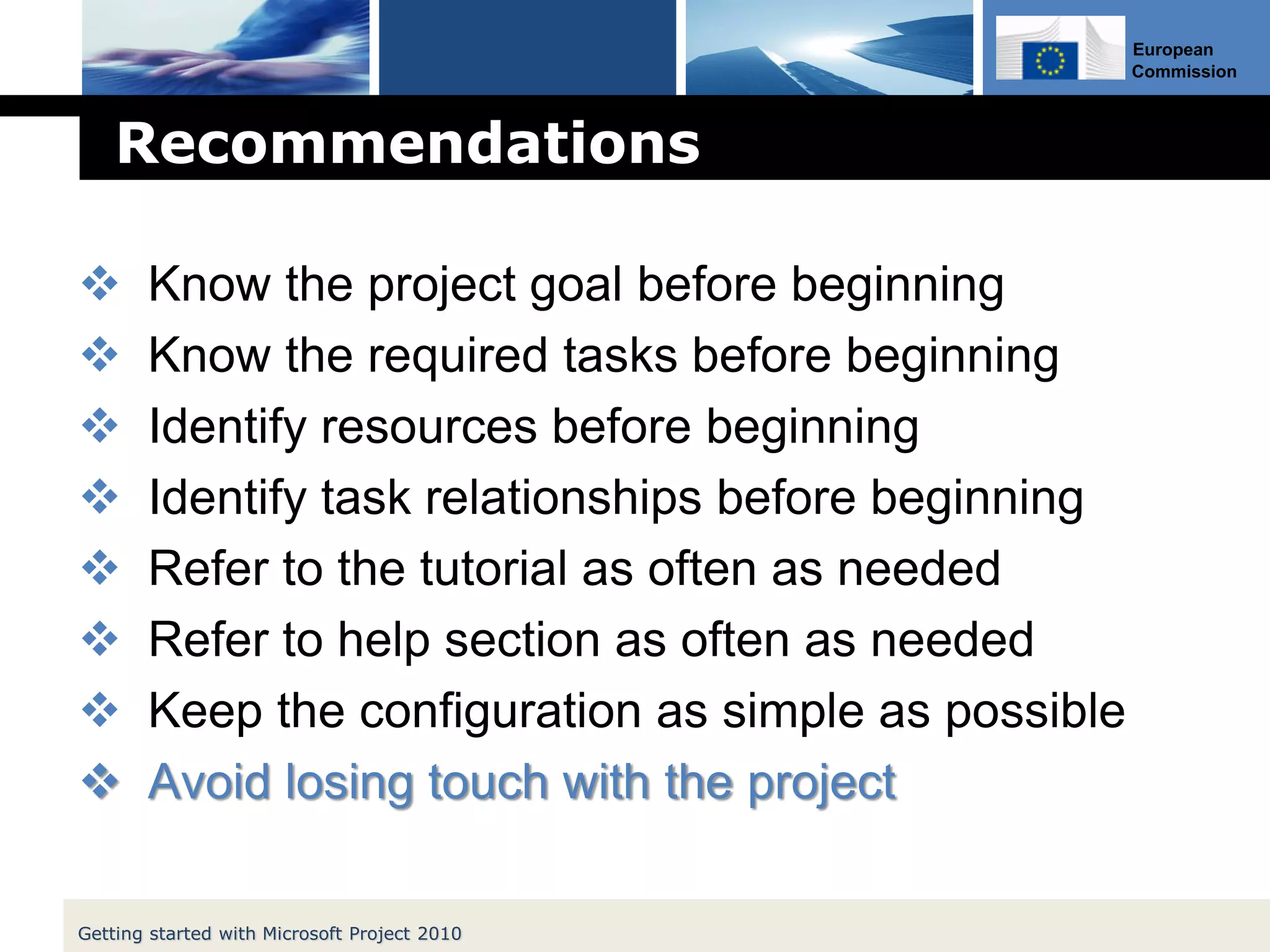

ï¶ Know the project goal before beginning
ï¶ Know the required tasks before beginning
ï¶ Identify resources before beginning
ï¶ Identify task relationships before beginning
ï¶ Refer to the tutorial as often as needed
ï¶ Refer to help section as often as needed
ï¶ Keep the configuration as simple as possible
ï¶ Avoid losing touch with the project
Getting started with Microsoft Project 2010
56. European
Commission

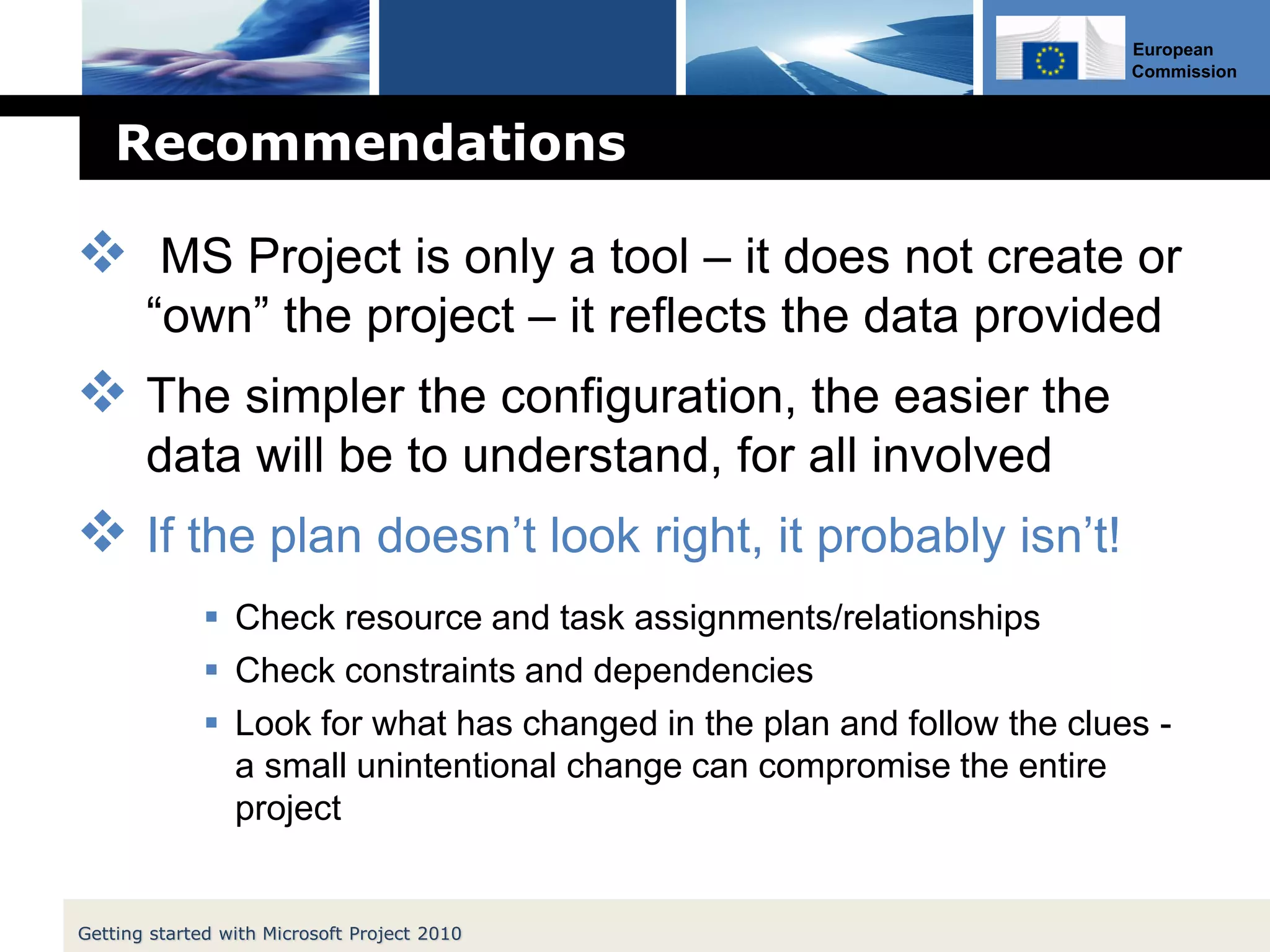

Recommendations
ï¶ MS Project is only a tool â it does not create or
âownâ the project â it reflects the data provided
ï¶ The simpler the configuration, the easier the
data will be to understand, for all involved
ï¶ If the plan doesnât look right, it probably isnât!
ï§ Check resource and task assignments/relationships
ï§ Check constraints and dependencies
ï§ Look for what has changed in the plan and follow the clues -
a small unintentional change can compromise the entire
project
Getting started with Microsoft Project 2010
57. European
Commission
Useful links
ï¶ Getting started with Project 2010
(Microsoft Office online training
video)
ï¶ Support on Project 2010
(Microsoft Office Support page)
ï¶ Finding answers, sharing ideas
and solving problems related to
Project 2010 (Microsoft
Community)
ï¶ Microsoft Project 2010 â 1
(Course material from Georgia
Technology Authority)
Getting started with Microsoft Project 2010
