Earned Value Management Fundamentals

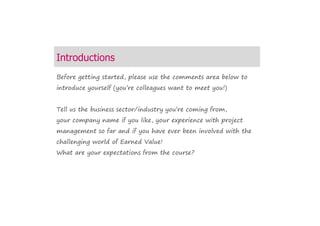

Welcome to the course
Introduction
Before getting started, please use the comments area below to
introduce yourself (you’re colleagues want to meet you!)
Tell us the business sector/industry you’re coming from,
your company name if you like, your experience with project
management so far and if you have ever been involved with the
challenging world of Earned Value!
What are your expectations from the course?

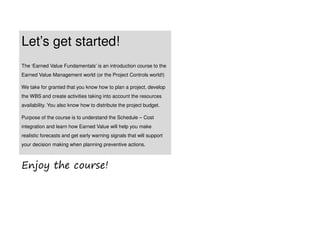

Let’s get started!
The ‘Earned Value Fundamentals’ is an introduction course to the
Earned Value Management world (or the Project Controls world!)
We take for granted that you know how to plan a project, develop
the WBS and create activities taking into account the resources
availability. You also know how to distribute the project budget.
Purpose of the course is to understand the Schedule – Cost
integration and learn how Earned Value will help you make
realistic forecasts and get early warning signals that will support
your decision making when planning preventive actions.
Enjoy the course!
identify
stakeholders
scope
WBS
activities
resources
costs
communications
coordinate
resources
manage
stakeholders
scope
schedule
costs
resources
reporting
lessons learnt
dismiss team
close project
Planning Executing ClosingMonitor &
Control
Initiating

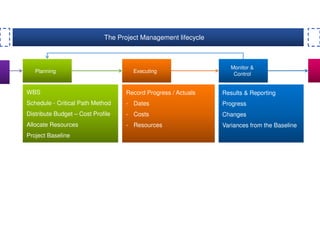

The Project Management lifecycle
Planning Executing
Monitor &
Control
The Project Management lifecycle
WBS

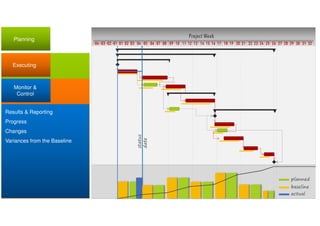

Schedule - Critical Path Method
Distribute Budget – Cost Profile
Allocate Resources
Project Baseline
Record Progress / Actuals
- Dates
- Costs
- Resources
Results & Reporting
Progress
Changes
Variances from the Baseline

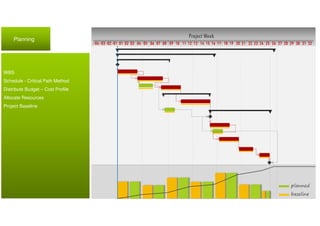

Planning
WBS
Schedule - Critical Path Method
Distribute Budget – Cost Profile
Allocate Resources
Project Baseline
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline
Planning
WBS
Critical Path Method
Distribute Budget – Cost Profile
Allocate Resources
Project Baseline
Executing
Record Progress / Actuals
- Dates
- Costs
- Resources
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline
actual
status
date
Planning
WBS
Critical Path Method
Distribute Budget – Cost Profile
Allocate Resources
Project Baseline
Executing
Monitor &
Control
Results & Reporting
Progress
Changes
Variances from the Baseline
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline
actual
status
date

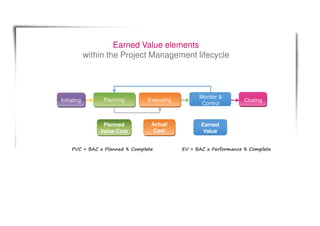

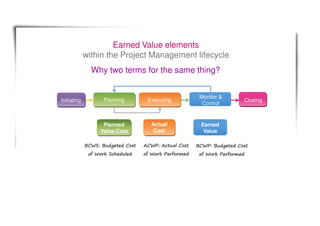

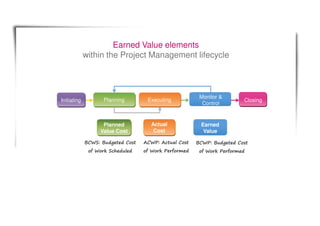

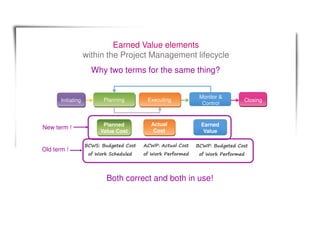

Earned Value ElementsEarned Value ElementsEarned Value ElementsEarned Value Elements
Planning Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline

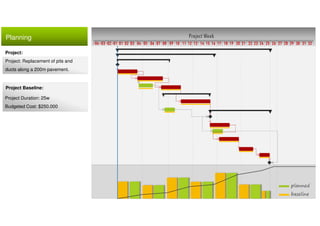

Project:
Project: Replacement of pits and
ducts along a 200m pavement.
Project Duration: 25w
Budgeted Cost: $250.000
Project Baseline:
Planning Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline
Project:
Project: Replacement of pits and
ducts along a 200m pavement.
Project Duration: 25w
Budgeted Cost: $250.000
Project Baseline:

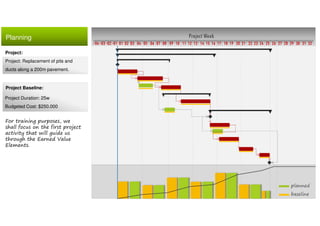

For training purposes, we
shall focus on the first project
activity that will guide us
through the Earned Value
Elements.
Planning Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline
Project:
Project: Replacement of pits and
ducts along a 200m pavement.

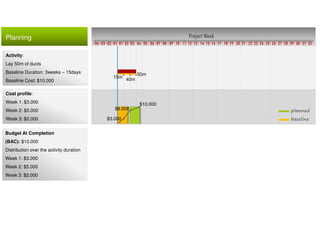

Activity:
Lay 50m of ducts
Baseline Duration: 3weeks – 15days
Baseline Cost: $10.000
Project Duration: 25w
Budgeted Cost: $250.000
Project Baseline:
Cost profile:
Week 1: $3.000
Week 2: $5.000
Week 3: $2.000
$250,000
Planning Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline
Activity:
Lay 50m of ducts
Baseline Duration: 3weeks – 15days
Baseline Cost: $10.000
Cost profile:
Week 1: $3.000
Week 2: $5.000
Week 3: $2.000 $3.000
$8.000
$10.000
15m
40m
50m

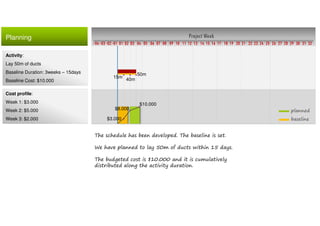

The schedule has been developed. The baseline is set.
We have planned to lay 50m of ducts within 15 days.
The budgeted cost is $10.000 and it is cumulatively
distributed along the activity duration.
Planning Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline
Activity:
Lay 50m of ducts
Baseline Duration: 3weeks – 15days
Baseline Cost: $10.000
Cost profile:
Week 1: $3.000
Week 2: $5.000
Week 3: $2.000 $3.000
$8.000
$10.000
15m
40m
50m
Budget At Completion
(BAC): $10.000
Distribution over the activity duration
Week 1: $3.000
Week 2: $5.000
Week 3: $2.000
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
The schedule has been
developed. The baseline is set
and the BAC has been agreed.
We have planned to lay 50m
of ducts within 15 days.
The baseline cost, is $10.000
and it is cumulatively
distributed along the activity
duration.
The BAC is not standing alone.
For each week of the activity a
specific amount of work has
been planned to be performed.
Budget At Completion (BAC): $10.000
Period Cumulative
$3.000 $3.000
$5.000 $8.000
$2.000 $10.000
Work Planned: 50m of ducts
Period Cumulative
Week 1: 15m 15m
Week 2: 25m 40m
Week 3: 10m 50m
Activity Duration: 15d
Period Cumulative
5d 5d
5d 10d
5d 15d
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m

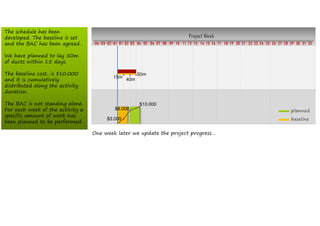

One week later we update the project progress…
The schedule has been
developed. The baseline is set
and the BAC has been agreed.
We have planned to lay 50m
of ducts within 15 days.
The baseline cost, is $10.000
and it is cumulatively
distributed along the activity
duration.
The BAC is not standing alone.
For each week of the activity a
specific amount of work has
been planned to be performed.

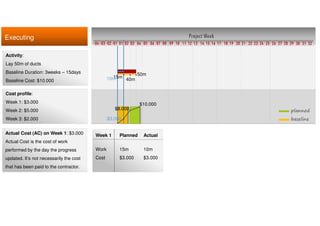

Executing Project Week
Activity:
Lay 50m of ducts
Baseline Duration: 3weeks – 15days
Baseline Cost: $10.000
Cost profile:
Week 1: $3.000
Week 2: $5.000
Week 3: $2.000
We planned to lay 15meters within the first five days.
However, one week later when the progress updated,
only 10m were completed.
The actual activity cost is so far $3.000.
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m

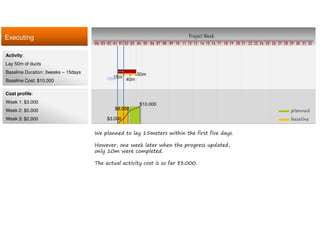

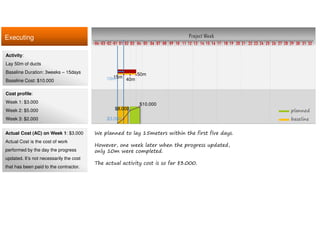

Executing Project Week
Activity:
Lay 50m of ducts
Baseline Duration: 3weeks – 15days
Baseline Cost: $10.000
Cost profile:
Week 1: $3.000
Week 2: $5.000
Week 3: $2.000
We planned to lay 15meters within the first five days.
However, one week later when the progress updated,
only 10m were completed.
The actual activity cost is so far $3.000.
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m

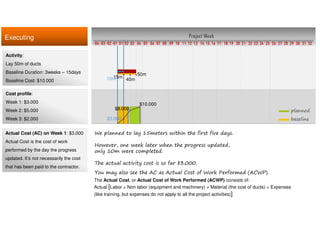

Actual Cost (AC) on Week 1: $3.000
Actual Cost is the cost of work
performed by the day the progress
updated. It’s not necessarily the cost
that has been paid to the contractor.
Executing Project Week
Activity:
Lay 50m of ducts
Baseline Duration: 3weeks – 15days
Baseline Cost: $10.000
Cost profile:
Week 1: $3.000
Week 2: $5.000
Week 3: $2.000
We planned to lay 15meters within the first five days.
However, one week later when the progress updated,
only 10m were completed.
The actual activity cost is so far $3.000.
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
Actual Cost (AC) on Week 1: $3.000
Actual Cost is the cost of work
performed by the day the progress
updated. It’s not necessarily the cost
that has been paid to the contractor.

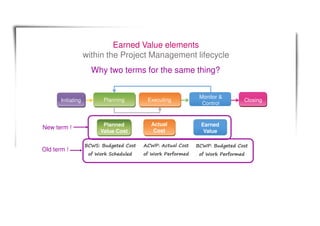

You may also see the AC as Actual Cost of Work Performed (ACWP).
The Actual Cost, or Actual Cost of Work Performed (ACWP) consists of:
Actual [Labor + Non labor (equipment and machinery) + Material (the cost of ducts) + Expenses
(like training, but expenses do not apply to all the project activities)]
Executing Project Week
Activity:
Lay 50m of ducts
Baseline Duration: 3weeks – 15days
Baseline Cost: $10.000
Cost profile:
Week 1: $3.000
Week 2: $5.000
Week 3: $2.000
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
Actual Cost (AC) on Week 1: $3.000
Actual Cost is the cost of work
performed by the day the progress
updated. It’s not necessarily the cost
that has been paid to the contractor.
Week 1 Planned Actual
Work 15m 10m
Cost $3.000 $3.000
Project Week

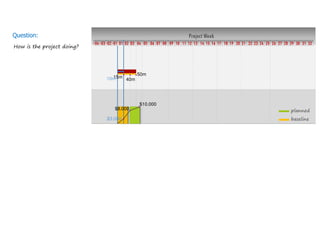

How is the project doing?
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m

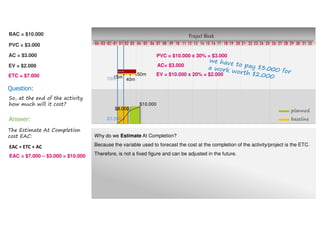

Question:
Project Week
How is the project doing?
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
Question:

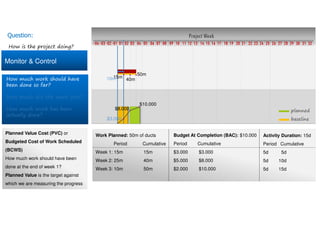

Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m

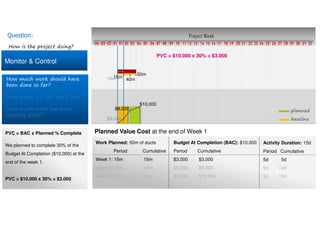

10m

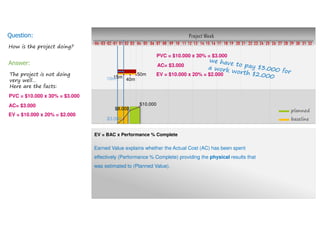

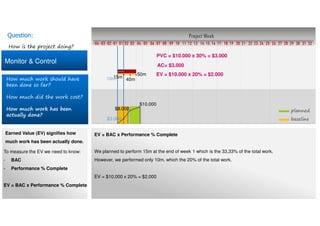

How is the project doing?

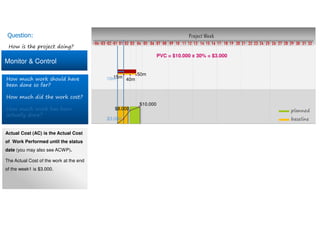

Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
Budget At Completion (BAC): $10.000
Period Cumulative
$3.000 $3.000
$5.000 $8.000
$2.000 $10.000
Work Planned: 50m of ducts
Period Cumulative
Week 1: 15m 15m
Week 2: 25m 40m
Week 3: 10m 50m
Activity Duration: 15d
Period Cumulative
5d 5d
5d 10d
5d 15d

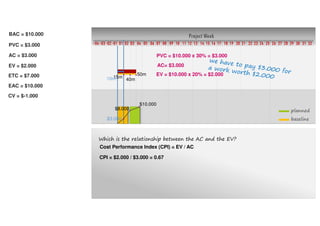

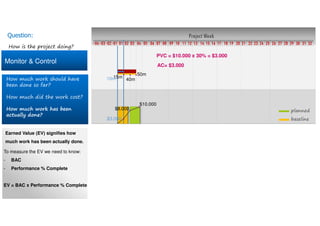

Planned Value Cost (PVC) or
Budgeted Cost of Work Scheduled
(BCWS)
How much work should have been
done at the end of week 1?
Planned Value is the target against
which we are measuring the progress
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
Budget At Completion (BAC): $10.000
Period Cumulative
$3.000 $3.000
$5.000 $8.000
$2.000 $10.000
Work Planned: 50m of ducts
Period Cumulative
Week 1: 15m 15m
Week 2: 25m 40m
Week 3: 10m 50m
Activity Duration: 15d
Period Cumulative
5d 5d
5d 10d
5d 15d
Planned Value Cost (PVC) or
Budgeted Cost of Work Scheduled
(BCWS)
How much work should have been
done at the end of week 1?
Planned Value is the target against
which we are measuring the progress
Planned Value Cost at the end of Week 1
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
Budget At Completion (BAC): $10.000
Period Cumulative
$3.000 $3.000
$5.000 $8.000
$2.000 $10.000
Work Planned: 50m of ducts
Period Cumulative
Week 1: 15m 15m
Week 2: 25m 40m
Week 3: 10m 50m
Activity Duration: 15d
Period Cumulative
5d 5d
5d 10d
5d 15d
PVC = BAC x Planned % Complete Planned Value Cost at the end of Week 1
We planned to complete 30% of the
Budget At Completion ($10.000) at the
end of the week 1.
PVC = $10.000 x 30% = $3.000
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Budget At Completion (BAC): $10.000
Period Cumulative
$3.000 $3.000
$5.000 $8.000
$2.000 $10.000
Work Planned: 50m of ducts
Period Cumulative
Week 1: 15m 15m
Week 2: 25m 40m
Week 3: 10m 50m
Activity Duration: 15d
Period Cumulative
5d 5d
5d 10d
5d 15d
PVC = BAC x Planned % Complete Planned Value Cost at the end of Week 1
We planned to complete 30% of the
Budget At Completion ($10.000) at the
end of the week 1.
PVC = $10.000 x 30% = $3.000
PVC = $10.000 x 30% = $3.000
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Actual Cost (AC) is the Actual Cost
of Work Performed until the status
date (you may also see ACWP).
The Actual Cost of the work at the end
of the week1 is $3.000.
PVC = $10.000 x 30% = $3.000
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Actual Cost (AC) is the Actual Cost
of Work Performed until the status
date (you may also see ACWP).
The Actual Cost of the work at the end
of the week1 is $3.000.
PVC = $10.000 x 30% = $3.000
AC= $3.000
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Actual Cost (AC) is the Actual Cost
of Work Performed until the status
date (you may also see ACWP).
The Actual Cost of the work at the end
of the week1 is $3.000.
PVC = $10.000 x 30% = $3.000
AC= $3.000 It doesn’t look that bad, right?
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?

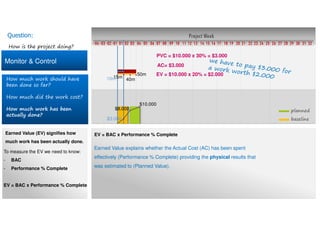

Earned Value (EV) signifies how
much work has been actually done.
To measure the EV we need to know:
- BAC
- Performance % Complete
EV = BAC x Performance % Complete
PVC = $10.000 x 30% = $3.000
AC= $3.000
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Earned Value (EV) signifies how
much work has been actually done.
To measure the EV we need to know:
- BAC
- Performance % Complete
EV = BAC x Performance % Complete
PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
We planned to perform 15m at the end of week 1 which is the 33,33% of the total work.
However, we performed only 10m, which the 20% of the total work.
EV = $10.000 x 20% = $2.000
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Earned Value (EV) signifies how
much work has been actually done.
To measure the EV we need to know:
- BAC
- Performance % Complete
EV = BAC x Performance % Complete
PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
We planned to perform 15m at the end of week 1 which is the 33,33% of the total work.
However, we performed only 10m, which the 20% of the total work.
EV = $10.000 x 20% = $2.000
EV = $10.000 x 20% = $2.000
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Earned Value (EV) signifies how
much work has been actually done.
To measure the EV we need to know:
- BAC
- Performance % Complete
EV = BAC x Performance % Complete
PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
We planned to perform 15m at the end of week 1 which is the 33,33% of the total work.
However, we performed only 10m, which the 20% of the total work.
EV = $10.000 x 20% = $2.000
EV = $10.000 x 20% = $2.000
Monitor & Control
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
How is the project doing?
Question:
How much work should have
been done so far?
How much did the work cost?
How much work has been
actually done?
Earned Value (EV) signifies how
much work has been actually done.
To measure the EV we need to know:
- BAC
- Performance % Complete
EV = BAC x Performance % Complete
PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
EV = $10.000 x 20% = $2.000
Earned Value explains whether the Actual Cost (AC) has been spent
effectively (Performance % Complete) providing the physical results that
was estimated to (Planned Value).
How is the project doing?
Question: Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
EV = $10.000 x 20% = $2.000
Earned Value explains whether the Actual Cost (AC) has been spent
effectively (Performance % Complete) delivering the physical results
that was estimated to (Planned Value).
The project is not doing
very well…
Here are the facts:
Answer:
PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = $10.000 x 20% = $2.000

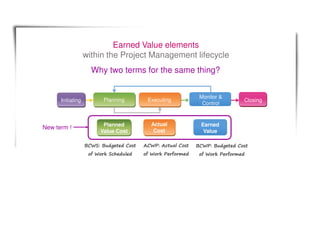

Earned Value elements
within the Project Management lifecycle
Planning Executing Closing
Monitor &
Control
Planned
Value Cost
Actual
Cost
Earned
Value
Initiating
EV = BAC x Performance % CompletePVC = BAC x Planned % Complete
Earned Value elements
within the Project Management lifecycle
Planning Executing Closing
Monitor &
Control
Planned
Value Cost
Actual
Cost
Earned
Value
Initiating
BCWP: Budgeted Cost
of Work Performed
BCWS: Budgeted Cost
of Work Scheduled
ACWP: Actual Cost
of Work Performed
Earned Value elements
within the Project Management lifecycle
Planning Executing Closing
Monitor &
Control
Planned
Value Cost
Actual
Cost
Earned
Value
Initiating
BCWP: Budgeted Cost
of Work Performed
BCWS: Budgeted Cost
of Work Scheduled
ACWP: Actual Cost
of Work Performed
Why two terms for the same thing?
Earned Value elements
within the Project Management lifecycle
Planning Executing Closing
Monitor &
Control
Planned
Value Cost
Actual
Cost
Earned
Value
Initiating
BCWP: Budgeted Cost
of Work Performed
BCWS: Budgeted Cost
of Work Scheduled
ACWP: Actual Cost
of Work Performed
Why two terms for the same thing?
New term !
Earned Value elements
within the Project Management lifecycle
Planning Executing Closing
Monitor &
Control
Planned
Value Cost
Actual
Cost
Earned
Value
Initiating
BCWP: Budgeted Cost
of Work Performed
BCWS: Budgeted Cost
of Work Scheduled
ACWP: Actual Cost
of Work Performed
Why two terms for the same thing?
New term !
Old term !
Earned Value elements
within the Project Management lifecycle
Planning Executing Closing
Monitor &
Control
Planned
Value Cost
Actual
Cost
Earned
Value
Initiating
BCWP: Budgeted Cost
of Work Performed
BCWS: Budgeted Cost
of Work Scheduled
ACWP: Actual Cost
of Work Performed
Why two terms for the same thing?
New term !
Old term !
Both correct and both in use!

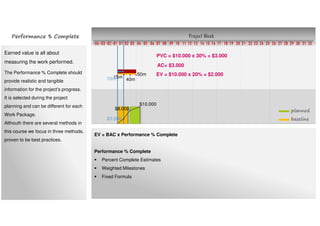

Measuring the Earned Value
the Performance % Complete type
EV = BAC x Performance % Complete
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
Earned value is all about
measuring the work performed.
The Performance % Complete should
provide realistic and tangible
information for the project’s progress.
It is selected during the project
planning and can be different for each
Work Package.
Althouth there are several methods in
this course we focus in three methods,
proven to be best practices.
PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
Performance % Complete
Percent Complete Estimates

Weighted Milestones

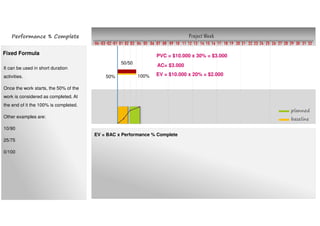

Fixed Formula
EV = $10.000 x 20% = $2.000
Performance % Complete
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
Percent Complete Estimates

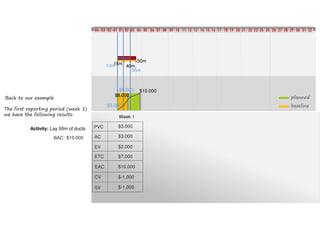

PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
EV = $10.000 x 20% = $2.000
Performance % Complete
It's the most commonly used
measurement method as it's easy to
administer within the already complex
project environment. However it is
subjective and often relies on the
project manger's perspective.
Expert judgment, experience and
comprehensive understanding of the
project scope are the requirements to
maximize the benefits of the %
complete estimates in the project.
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m

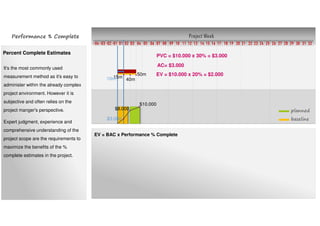

Percent Complete Estimates
PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
EV = $10.000 x 20% = $2.000
Performance % Complete
It's the most commonly used
measurement method as it's easy to
administer within the already complex
project environment. However it is
subjective and often relies on the
project manger's perspective.
Expert judgment, experience and
comprehensive understanding of the
project scope are the requirements to
maximize the benefits of the %
complete estimates in the project.

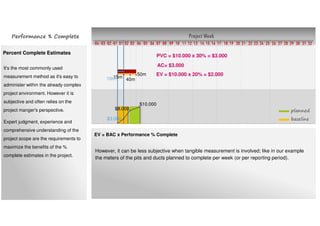

However, it can be less subjective when tangible measurement is involved; like in our example
the meters of the pits and ducts planned to complete per week (or per reporting period).
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline

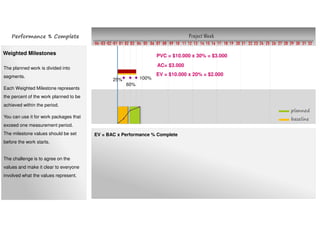

Weighted Milestones PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
EV = $10.000 x 20% = $2.000
Performance % Complete
The planned work is divided into
segments.
Each Weighted Milestone represents
the percent of the work planned to be
achieved within the period.
You can use it for work packages that
exceed one measurement period.
The milestone values should be set
before the work starts.
The challenge is to agree on the
values and make it clear to everyone
involved what the values represent.
25%
60%
100%
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline
Fixed Formula PVC = $10.000 x 30% = $3.000
AC= $3.000
EV = BAC x Performance % Complete
EV = $10.000 x 20% = $2.000
Performance % Complete
It can be used in short duration
activities.
Once the work starts, the 50% of the
work is considered as completed. At
the end of it the 100% is completed.
Other examples are:
10/90
25/75
0/100
50% 100%
50/50
Forecasting the project’s future using EVM
Forecasting the project’s future using EVM
it's time to get some meaningful results from the project
and try to forecast the future of the project realistically
Forecasting the project’s future using EVM
it's time to get some meaningful results from the project
and try to forecast the future of the project realistically

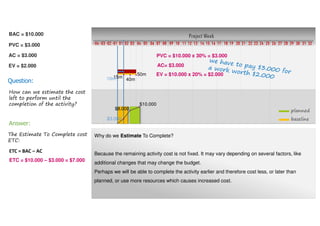

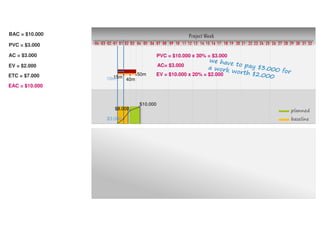

Estimate To Complete
How can we estimate the cost
left to perform until the
completion of the activity?
Question:
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
Estimate To Complete cost
ETC:

Answer:
ETC = Remaining cost of work
(40m*$200/m)
ETC = $8.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
PVC = $10.000 x 30% = $3.000
How can we estimate the cost
left to perform until the
completion of the activity?
Question:
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
Why do we Estimate To Complete?
Because the remaining cost of work is not always fixed. It may vary depending on several factors,
like additional changes that may change the budget.
Perhaps we will be able to complete the activity earlier and therefore cost less, or later than
planned, or use more resources which causes increased cost.
EV = $10.000 x 20% = $2.000
Estimate To Complete cost
ETC:
Answer:
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
PVC = $10.000 x 30% = $3.000
ETC = Remaining cost of work
(40m*$200/m)
ETC = $8.000
Forecasting the project’s future using EVM
it's time to get some meaningful results from the project
and try to forecast the future of the project realistically
Estimate At Completion
So, at the end of the activity
how much will it cost?
Question:
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
Why do we Estimate At Completion?
Because the variable used to forecast the cost at the completion of the activity/project is the ETC.
Therefore, is not a fixed figure and can be adjusted in the future.
EV = $10.000 x 20% = $2.000
The Estimate At Completion
cost EAC:
Answer:
EAC = ETC + AC
EAC = $8.000 + $3.000 = $11.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $8.000
PVC = $10.000 x 30% = $3.000
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $11.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $8.000
PVC = $10.000 x 30% = $3.000
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $11.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $8.000
PVC = $10.000 x 30% = $3.000

How is Earned Value involved with all this?
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $11.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $8.000
PVC = $10.000 x 30% = $3.000

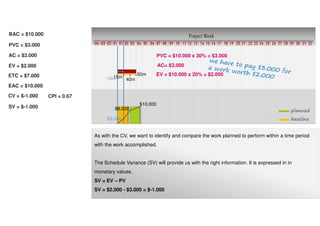

Earned Value and Cost Performance
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $11.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $8.000
PVC = $10.000 x 30% = $3.000

Don’t forget that our activity is already underperforming.
The ETC and EAC reflect the current status of the activity/project. However, at this point they don’t
include the cost of delay or underperformance.
Identifying the cost variance between the AC and EV enable us a more realistic picture of the
activity performance at the current time period.
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $11.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $8.000
PVC = $10.000 x 30% = $3.000
Cost Variance (CV) = EV - AC
CV = $2.000 - $3.000 = $-1.000
CV = $-1.000
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $10.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $7.000
PVC = $10.000 x 30% = $3.000
CV = $-1.000
Which is the relationship between the AC and the EV?

Cost Performance Index (CPI) = EV / AC
CPI = $2.000 / $3.000 = 0.67
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $10.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $7.000
PVC = $10.000 x 30% = $3.000
CV = $-1.000
Which is the relationship between the AC and the EV?

Cost Performance Index (CPI) = EV / AC
CPI = $2.000 / $3.000 = 0.67
In simple terms, for each dollar spent, only 0.67 worth paying!
CPI = 0.67
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $10.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $7.000
PVC = $10.000 x 30% = $3.000
Earned Value and Schedule Performance
CV = $-1.000 CPI = 0.67
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $10.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $7.000
PVC = $10.000 x 30% = $3.000
CV = $-1.000 CPI = 0.67

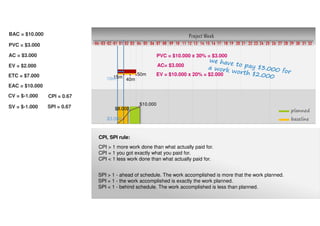

As with the CV, we want to identify and compare the work planned to perform within a time period
with the work accomplished.
The Schedule Variance (SV) will provide us with the right information. It is expressed in in
monetary values.
SV = EV – PV
SV = $2.000 - $3.000 = $-1.000
SV = $-1.000
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $10.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $7.000
PVC = $10.000 x 30% = $3.000
CV = $-1.000 CPI = 0.67
SV = $-1.000

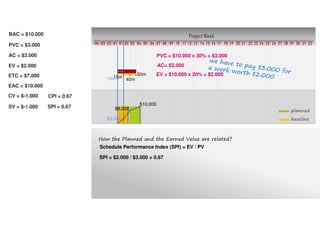

How the Planned and the Earned Value are related?
Schedule Performance Index (SPI) = EV / PV
SPI = $2.000 / $3.000 = 0.67
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $10.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $7.000
PVC = $10.000 x 30% = $3.000
CV = $-1.000 CPI = 0.67
SV = $-1.000
How the Planned and the Earned Value are related?
Schedule Performance Index (SPI) = EV / PV
SPI = $2.000 / $3.000 = 0.67
SPI = 0.67
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
AC= $3.000
EV = $10.000 x 20% = $2.000
EAC = $10.000
PVC = $3.000
AC = $3.000
EV = $2.000
BAC = $10.000
ETC = $7.000
PVC = $10.000 x 30% = $3.000
CV = $-1.000 CPI = 0.67
SV = $-1.000
CPI, SPI rule:
CPI > 1 more work done than what actually paid for.
CPI = 1 you got exactly what you paid for.
CPI < 1 less work done than what actually paid for.
SPI > 1 - ahead of schedule. The work accomplished is more that the work planned.
SPI = 1 - the work accomplished is exactly the work planned.
SPI < 1 - behind schedule. The work accomplished is less than planned.
SPI = 0.67
Reporting
Earned Value
Reporting
Earned Value
Now that we know what Earned Value means, how it’s used and why
it can make a big difference in a project, we need to know how to
present and report data.
Reporting
Earned Value
Now that we know what Earned Value means, how it’s used and why
it can make a big difference in a project, we need to know how to
present and report data.
Tables and diagrams help to communicate the message clearly and
can be used in meetings for decision making.
Reporting
Earned Value
Now that we know what Earned Value means, how it’s used and why
it can make a big difference in a project, we need to know how to
present and report data.
Tables and diagrams help to communicate the message clearly and
can be used in meetings for decision making.
The Earned Value data are reported cumulatively.
The cumulative data represent a comprehensive project picture as they
incorporate the overall project performance up to date.
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m

PVC
AC
EV
BAC:
Activity: Lay 50m of ducts
Week 1
ETC
CV
$10.000
$3.000
$3.000
$2.000
$8.000
$11.000
$-1.000
SV $-1.000
EAC
35m
$9.000

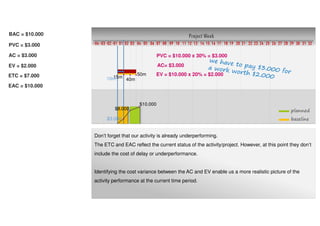

The first reporting period (week 1)
we have the following results:
Back to our example
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
BAC:
Activity: Lay 50m of ducts
Week 1
$10.000
35m
$9.000
1
0.5
1.5
0.67
0.67
CPI SPI
W1
The first reporting period (week 1)
we have the following results:
PVC
AC
EV
ETC
CV
$3.000
$3.000
$2.000
$8.000
$11.000
$-1.000
SV $-1.000
EAC
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
BAC:
Activity: Lay 50m of ducts
Week 1
$10.000
35m
$9.000
1
0.5
1.5
0.67
0.67
CPI SPI
W1

The second reporting period (week
2) the activity performance is:
PVC
AC
EV
ETC
CV
$3.000
$3.000
$2.000
$8.000
$11.000
$-1.000
SV $-1.000
EAC
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
PVC
AC
EV
BAC:
Activity: Lay 50m of ducts
Week 1 Week 2
ETC
CV
$10.000
$3.000
$3.000
$2.000
$8.000
$11.000
$-1.000
$8.000
$9.000
$7.000
$3.000
$12.000
$-2.000
SV $-1.000 $-1.000
EAC
35m
$9.000
1
0.5
1.5
0.67
0.67
CPI SPI
W1
The second reporting period (week
2) the activity performance is:
Project Week
10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09
planned
baseline$3.000
$8.000
$10.000
15m
40m
50m
10m
PVC
AC
EV
BAC:
Activity: Lay 50m of ducts
Week 1 Week 2
ETC
CV
$10.000
$3.000
$3.000
$2.000
$8.000
$11.000
$-1.000
$8.000
$9.000
$7.000
$3.000
$12.000
$-2.000
SV $-1.000 $-1.000
EAC
35m
$9.000
1
0.5
1.5
0.67
0.78
0.67
0.87
CPI SPI
W1 W2
The second reporting period (week
2) the activity performance is:
Reporting
Earned Value
When reporting Earned Value, consistency is everything!
Only when the reporting periods are relevant you can get
meaningful reports!
Thanks for attending
EVM Fundamentals!
Denise Fotopoulou

More Related Content

What's hot

Projects Performance Analysis & Forecasting
Projects Performance Analysis & Forecasting Projects Performance Analysis & Forecasting
Earned value management
Earned value managementEarned value management
Earned value management
Ar. Faisal Husaini

Earned value management for Beginners
Earned value management for Beginners Earned value management for Beginners
Earned value management for Beginners
Shenin Hassan

Earned Value Analysis
Earned Value AnalysisEarned Value Analysis
Earned Value Analysis
David Edgeworth

Jason douglas earned value 1 0
Jason douglas earned value 1 0Jason douglas earned value 1 0
Jason douglas earned value 1 0
Jason Douglas

Project Management Earned Value
Project Management Earned ValueProject Management Earned Value
Project Management Earned Value
constructioninside

The Benefits of using Earned Value Management
The Benefits of using Earned Value ManagementThe Benefits of using Earned Value Management
The Benefits of using Earned Value Management
Association for Project Management

Earned Value Management
Earned Value ManagementEarned Value Management
Earned Value Management
Anand Subramaniam

Earned value Project Management (evpm)
Earned value Project Management (evpm)Earned value Project Management (evpm)
Earned value Project Management (evpm)
Ejaz Bhatti

Earned value analysis (1)
Earned value analysis (1)Earned value analysis (1)
Earned value analysis (1)
Harshit Mahajan

Earned value analysis training
Earned value analysis trainingEarned value analysis training
Earned value analysis training
Paul King

Earned Value Management
Earned Value ManagementEarned Value Management
Earned Value Management
Russell Taylor BEng CEng FAPM FIET

Earned value management
Earned value managementEarned value management
Earned value management
Ashif AR

Earned Value Analysis
Earned Value AnalysisEarned Value Analysis
Earned Value Analysis
Saqib Raza

Earned value for pmp and pmi acp exam
Earned value for pmp and pmi acp examEarned value for pmp and pmi acp exam
Earned value for pmp and pmi acp exam
Manish Purwar

Earned value analysis
Earned value analysisEarned value analysis
Earned value analysis
Nikhil Raj

Project Control Process
Project Control ProcessProject Control Process
Project Control Process
haroldtaylor1113

Earned Value Analysis
Earned Value AnalysisEarned Value Analysis
Earned Value Analysis
Ahmed Rami Elsherif, PMP, ITBMC

Earned value
Earned valueEarned value
Earned value
Oliver

Earned value analysis for a construction project
Earned value analysis for a construction projectEarned value analysis for a construction project
Earned value analysis for a construction project
IAEME Publication

What's hot (20)

Projects Performance Analysis & Forecasting
Projects Performance Analysis & Forecasting Projects Performance Analysis & Forecasting
Projects Performance Analysis & Forecasting

Earned value management
Earned value managementEarned value management
Earned value management

Earned value management for Beginners
Earned value management for Beginners Earned value management for Beginners
Earned value management for Beginners

Earned Value Analysis
Earned Value AnalysisEarned Value Analysis
Earned Value Analysis

Jason douglas earned value 1 0
Jason douglas earned value 1 0Jason douglas earned value 1 0
Jason douglas earned value 1 0

Project Management Earned Value
Project Management Earned ValueProject Management Earned Value
Project Management Earned Value

The Benefits of using Earned Value Management
The Benefits of using Earned Value ManagementThe Benefits of using Earned Value Management
The Benefits of using Earned Value Management

Earned Value Management
Earned Value ManagementEarned Value Management
Earned Value Management

Earned value Project Management (evpm)
Earned value Project Management (evpm)Earned value Project Management (evpm)
Earned value Project Management (evpm)

Earned value analysis (1)
Earned value analysis (1)Earned value analysis (1)
Earned value analysis (1)

Earned value analysis training
Earned value analysis trainingEarned value analysis training
Earned value analysis training

Earned Value Management
Earned Value ManagementEarned Value Management
Earned Value Management

Earned value management
Earned value managementEarned value management
Earned value management

Earned Value Analysis
Earned Value AnalysisEarned Value Analysis
Earned Value Analysis

Earned value for pmp and pmi acp exam
Earned value for pmp and pmi acp examEarned value for pmp and pmi acp exam
Earned value for pmp and pmi acp exam

Earned value analysis
Earned value analysisEarned value analysis
Earned value analysis

Project Control Process
Project Control ProcessProject Control Process
Project Control Process

Earned Value Analysis
Earned Value AnalysisEarned Value Analysis
Earned Value Analysis

Earned value
Earned valueEarned value
Earned value

Earned value analysis for a construction project
Earned value analysis for a construction projectEarned value analysis for a construction project
Earned value analysis for a construction project

Viewers also liked

Earned value management with Examples | Control Cost | PMBOK | PMP
Earned value management with Examples | Control Cost | PMBOK | PMPEarned value management with Examples | Control Cost | PMBOK | PMP
Earned value management with Examples | Control Cost | PMBOK | PMP
JustAcademy

A gentle introduction to earned value management systems (neutral)
A gentle introduction to earned value management systems (neutral)A gentle introduction to earned value management systems (neutral)
A gentle introduction to earned value management systems (neutral)
Glen Alleman

Earning Value from Earned Value Management
Earning Value from Earned Value ManagementEarning Value from Earned Value Management
Earning Value from Earned Value Management
Glen Alleman

People & Projects
People & ProjectsPeople & Projects
People & Projects
Denise Fotopoulou

Project Management - Keep it simple
Project Management - Keep it simpleProject Management - Keep it simple
Project Management - Keep it simple
Denise Fotopoulou

Integrating Risk With Earned Value
Integrating Risk With Earned ValueIntegrating Risk With Earned Value
Integrating Risk With Earned Value
Glen Alleman

Earned Value
Earned ValueEarned Value
Earned Value
ahmad bassiouny

Django10 cheat-sheet-grayscale
Django10 cheat-sheet-grayscaleDjango10 cheat-sheet-grayscale
Django10 cheat-sheet-grayscale
Amir Reza Zareian

EVMS Made Simple
EVMS Made SimpleEVMS Made Simple
EVMS Made Simple
Glen Alleman

Executive Overview of Managing Agile Programs with Earned Value
Executive Overview of Managing Agile Programs with Earned ValueExecutive Overview of Managing Agile Programs with Earned Value
Executive Overview of Managing Agile Programs with Earned Value
Glen Alleman

Earned Value Management Essentials
Earned Value Management EssentialsEarned Value Management Essentials
Earned Value Management Essentials
Glen Alleman

Project management practitioner or software user?
Project management practitioner or software user?Project management practitioner or software user?
Project management practitioner or software user?
Denise Fotopoulou

Jerald kerby
Jerald kerbyJerald kerby
Jerald kerby
NASAPMC

Learning Earned Value Management using Lego Bricks
Learning Earned Value Management using Lego BricksLearning Earned Value Management using Lego Bricks
Learning Earned Value Management using Lego Bricks
Youssef Mourra

Earned Value Management
Earned Value ManagementEarned Value Management
Earned Value Management
Tiago Franco

Earned value in five easy pieces
Earned value in five easy piecesEarned value in five easy pieces
Earned value in five easy pieces
Glen Alleman

Viewers also liked (16)

Earned value management with Examples | Control Cost | PMBOK | PMP
Earned value management with Examples | Control Cost | PMBOK | PMPEarned value management with Examples | Control Cost | PMBOK | PMP
Earned value management with Examples | Control Cost | PMBOK | PMP

A gentle introduction to earned value management systems (neutral)
A gentle introduction to earned value management systems (neutral)A gentle introduction to earned value management systems (neutral)
A gentle introduction to earned value management systems (neutral)

Earning Value from Earned Value Management
Earning Value from Earned Value ManagementEarning Value from Earned Value Management
Earning Value from Earned Value Management

People & Projects
People & ProjectsPeople & Projects
People & Projects

Project Management - Keep it simple
Project Management - Keep it simpleProject Management - Keep it simple
Project Management - Keep it simple

Integrating Risk With Earned Value
Integrating Risk With Earned ValueIntegrating Risk With Earned Value
Integrating Risk With Earned Value

Earned Value
Earned ValueEarned Value
Earned Value

Django10 cheat-sheet-grayscale
Django10 cheat-sheet-grayscaleDjango10 cheat-sheet-grayscale
Django10 cheat-sheet-grayscale

EVMS Made Simple
EVMS Made SimpleEVMS Made Simple
EVMS Made Simple

Executive Overview of Managing Agile Programs with Earned Value
Executive Overview of Managing Agile Programs with Earned ValueExecutive Overview of Managing Agile Programs with Earned Value
Executive Overview of Managing Agile Programs with Earned Value

Earned Value Management Essentials
Earned Value Management EssentialsEarned Value Management Essentials
Earned Value Management Essentials

Project management practitioner or software user?
Project management practitioner or software user?Project management practitioner or software user?
Project management practitioner or software user?

Jerald kerby
Jerald kerbyJerald kerby
Jerald kerby

Learning Earned Value Management using Lego Bricks
Learning Earned Value Management using Lego BricksLearning Earned Value Management using Lego Bricks
Learning Earned Value Management using Lego Bricks

Earned Value Management
Earned Value ManagementEarned Value Management
Earned Value Management

Earned value in five easy pieces
Earned value in five easy piecesEarned value in five easy pieces
Earned value in five easy pieces

Similar to Earned Value fundamentals

Foundations for New Champlain Bridge Corridor Project
Foundations for New Champlain Bridge Corridor ProjectFoundations for New Champlain Bridge Corridor Project
Foundations for New Champlain Bridge Corridor Project
Daksh Raj Chopra

Linking Budgets And Resources With Project Timelines
Linking Budgets And Resources With Project TimelinesLinking Budgets And Resources With Project Timelines
Linking Budgets And Resources With Project Timelines
BFieggen

Project assign 2
Project assign 2Project assign 2
Project assign 2
Moses Seriki

Symposium 2016 : CONF. 401 Jonathan Shriqui EVM: Go Beyond the Numbers
Symposium 2016 : CONF. 401  Jonathan Shriqui EVM: Go Beyond the NumbersSymposium 2016 : CONF. 401  Jonathan Shriqui EVM: Go Beyond the Numbers
Symposium 2016 : CONF. 401 Jonathan Shriqui EVM: Go Beyond the Numbers
PMI-Montréal

Culture Check on using Earned Value in Organization
Culture Check on using Earned Value in OrganizationCulture Check on using Earned Value in Organization
Culture Check on using Earned Value in Organization
Ghassan Kabbara

Project jksdjcdkwedkwdwkdjjkjkdjedddnjde
Project jksdjcdkwedkwdwkdjjkjkdjedddnjdeProject jksdjcdkwedkwdwkdjjkjkdjedddnjde
Project jksdjcdkwedkwdwkdjjkjkdjedddnjde
PalesaSemakale1

Work Pricing in construction projects by K C Iyer
Work Pricing in construction projects by K C IyerWork Pricing in construction projects by K C Iyer
Work Pricing in construction projects by K C Iyer
manishkumarsingh1110

Assignment 1 Principles Of Project Management Mthabisi Sibanda MANCOSA 130635
Assignment 1 Principles Of Project Management Mthabisi Sibanda MANCOSA 130635Assignment 1 Principles Of Project Management Mthabisi Sibanda MANCOSA 130635
Assignment 1 Principles Of Project Management Mthabisi Sibanda MANCOSA 130635
Claudia Acosta

coverpagePVsolarflowers
coverpagePVsolarflowerscoverpagePVsolarflowers
coverpagePVsolarflowers
Dessiray koss

Earned Value Management - Project Controls - Schedule Only.pptx
Earned Value Management - Project Controls - Schedule Only.pptxEarned Value Management - Project Controls - Schedule Only.pptx
Earned Value Management - Project Controls - Schedule Only.pptx
ssuser5fc1e7

team_contract.docxTeam ContractProject NameProject Team M.docx
team_contract.docxTeam ContractProject NameProject Team M.docxteam_contract.docxTeam ContractProject NameProject Team M.docx
team_contract.docxTeam ContractProject NameProject Team M.docx
bradburgess22840

team_contract.docxTeam ContractProject NameProject Team M.docx
team_contract.docxTeam ContractProject NameProject Team M.docxteam_contract.docxTeam ContractProject NameProject Team M.docx
team_contract.docxTeam ContractProject NameProject Team M.docx
deanmtaylor1545

130306 City Council Workshop
130306 City Council Workshop130306 City Council Workshop
130306 City Council Workshop
publicinvolvement

CAPM study session 4
CAPM study session 4CAPM study session 4
CAPM study session 4
Kinetic Potential

Project planning-and-control
Project planning-and-controlProject planning-and-control
Project planning-and-control
Jatindra Malik

Quiz 2-mspm iii1 03-398192-009
Quiz 2-mspm iii1 03-398192-009Quiz 2-mspm iii1 03-398192-009
Quiz 2-mspm iii1 03-398192-009
Samiullah Awan

Lecture7_2021_v2.pdf
Lecture7_2021_v2.pdfLecture7_2021_v2.pdf
Lecture7_2021_v2.pdf
ssuserc9da59

CE 162 Design Presentation
CE 162 Design PresentationCE 162 Design Presentation
CE 162 Design Presentation
Ryan Maidrand

building group 5
building group 5building group 5
building group 5
Hossein Khodaverdi M.Eng

Intro to PM.ppt
Intro to PM.pptIntro to PM.ppt
Intro to PM.ppt
Chandrabhan Seniya

Similar to Earned Value fundamentals (20)

Foundations for New Champlain Bridge Corridor Project
Foundations for New Champlain Bridge Corridor ProjectFoundations for New Champlain Bridge Corridor Project
Foundations for New Champlain Bridge Corridor Project

Linking Budgets And Resources With Project Timelines
Linking Budgets And Resources With Project TimelinesLinking Budgets And Resources With Project Timelines
Linking Budgets And Resources With Project Timelines

Project assign 2
Project assign 2Project assign 2
Project assign 2

Symposium 2016 : CONF. 401 Jonathan Shriqui EVM: Go Beyond the Numbers
Symposium 2016 : CONF. 401  Jonathan Shriqui EVM: Go Beyond the NumbersSymposium 2016 : CONF. 401  Jonathan Shriqui EVM: Go Beyond the Numbers
Symposium 2016 : CONF. 401 Jonathan Shriqui EVM: Go Beyond the Numbers

Culture Check on using Earned Value in Organization
Culture Check on using Earned Value in OrganizationCulture Check on using Earned Value in Organization
Culture Check on using Earned Value in Organization

Project jksdjcdkwedkwdwkdjjkjkdjedddnjde
Project jksdjcdkwedkwdwkdjjkjkdjedddnjdeProject jksdjcdkwedkwdwkdjjkjkdjedddnjde
Project jksdjcdkwedkwdwkdjjkjkdjedddnjde

Work Pricing in construction projects by K C Iyer
Work Pricing in construction projects by K C IyerWork Pricing in construction projects by K C Iyer
Work Pricing in construction projects by K C Iyer

Assignment 1 Principles Of Project Management Mthabisi Sibanda MANCOSA 130635
Assignment 1 Principles Of Project Management Mthabisi Sibanda MANCOSA 130635Assignment 1 Principles Of Project Management Mthabisi Sibanda MANCOSA 130635
Assignment 1 Principles Of Project Management Mthabisi Sibanda MANCOSA 130635

coverpagePVsolarflowers
coverpagePVsolarflowerscoverpagePVsolarflowers
coverpagePVsolarflowers

Earned Value Management - Project Controls - Schedule Only.pptx
Earned Value Management - Project Controls - Schedule Only.pptxEarned Value Management - Project Controls - Schedule Only.pptx
Earned Value Management - Project Controls - Schedule Only.pptx

team_contract.docxTeam ContractProject NameProject Team M.docx
team_contract.docxTeam ContractProject NameProject Team M.docxteam_contract.docxTeam ContractProject NameProject Team M.docx
team_contract.docxTeam ContractProject NameProject Team M.docx

team_contract.docxTeam ContractProject NameProject Team M.docx
team_contract.docxTeam ContractProject NameProject Team M.docxteam_contract.docxTeam ContractProject NameProject Team M.docx
team_contract.docxTeam ContractProject NameProject Team M.docx

130306 City Council Workshop
130306 City Council Workshop130306 City Council Workshop
130306 City Council Workshop

CAPM study session 4
CAPM study session 4CAPM study session 4
CAPM study session 4

Project planning-and-control
Project planning-and-controlProject planning-and-control
Project planning-and-control

Quiz 2-mspm iii1 03-398192-009
Quiz 2-mspm iii1 03-398192-009Quiz 2-mspm iii1 03-398192-009
Quiz 2-mspm iii1 03-398192-009

Lecture7_2021_v2.pdf
Lecture7_2021_v2.pdfLecture7_2021_v2.pdf
Lecture7_2021_v2.pdf

CE 162 Design Presentation
CE 162 Design PresentationCE 162 Design Presentation
CE 162 Design Presentation

building group 5
building group 5building group 5
building group 5

Intro to PM.ppt
Intro to PM.pptIntro to PM.ppt
Intro to PM.ppt

Recently uploaded

Cover Story - China's Investment Leader - Dr. Alyce SU
Cover Story - China's Investment Leader - Dr. Alyce SUCover Story - China's Investment Leader - Dr. Alyce SU
Cover Story - China's Investment Leader - Dr. Alyce SU
msthrill

Industrial Tech SW: Category Renewal and Creation
Industrial Tech SW:  Category Renewal and CreationIndustrial Tech SW:  Category Renewal and Creation
Industrial Tech SW: Category Renewal and Creation
Christian Dahlen

Part 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 SlowdownPart 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 Slowdown
jeffkluth1

Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
my Pandit

PM Surya Ghar Muft Bijli Yojana: Online Application, Eligibility, Subsidies &...
PM Surya Ghar Muft Bijli Yojana: Online Application, Eligibility, Subsidies &...PM Surya Ghar Muft Bijli Yojana: Online Application, Eligibility, Subsidies &...
PM Surya Ghar Muft Bijli Yojana: Online Application, Eligibility, Subsidies &...
Ksquare Energy Pvt. Ltd.

Prescriptive analytics BA4206 Anna University PPT
Prescriptive analytics BA4206 Anna University PPTPrescriptive analytics BA4206 Anna University PPT
Prescriptive analytics BA4206 Anna University PPT
Freelance

TIMES BPO: Business Plan For Startup Industry
TIMES BPO: Business Plan For Startup IndustryTIMES BPO: Business Plan For Startup Industry
TIMES BPO: Business Plan For Startup Industry
timesbpobusiness

Digital Transformation Frameworks: Driving Digital Excellence
Digital Transformation Frameworks: Driving Digital ExcellenceDigital Transformation Frameworks: Driving Digital Excellence
Digital Transformation Frameworks: Driving Digital Excellence
Operational Excellence Consulting

Satta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results Kalyan ChartSatta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results

The Steadfast and Reliable Bull: Taurus Zodiac Sign
The Steadfast and Reliable Bull: Taurus Zodiac SignThe Steadfast and Reliable Bull: Taurus Zodiac Sign
The Steadfast and Reliable Bull: Taurus Zodiac Sign
my Pandit

IMG_20240615_091110.pdf dpboss guessing
IMG_20240615_091110.pdf dpboss  guessingIMG_20240615_091110.pdf dpboss  guessing
The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...
The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...
The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...
APCO

2022 Vintage Roman Numerals Men Rings
2022 Vintage Roman  Numerals  Men  Rings2022 Vintage Roman  Numerals  Men  Rings
2022 Vintage Roman Numerals Men Rings
aragme

AI Transformation Playbook: Thinking AI-First for Your Business
AI Transformation Playbook: Thinking AI-First for Your BusinessAI Transformation Playbook: Thinking AI-First for Your Business
AI Transformation Playbook: Thinking AI-First for Your Business
Arijit Dutta

Science Around Us Module 2 Matter Around Us
Science Around Us Module 2 Matter Around UsScience Around Us Module 2 Matter Around Us
Science Around Us Module 2 Matter Around Us
PennapaKeavsiri

How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
Lacey Max

Discover the Beauty and Functionality of The Expert Remodeling Service
Discover the Beauty and Functionality of The Expert Remodeling ServiceDiscover the Beauty and Functionality of The Expert Remodeling Service
Discover the Beauty and Functionality of The Expert Remodeling Service
obriengroupinc04

Pitch Deck Teardown: Kinnect's $250k Angel deck
Pitch Deck Teardown: Kinnect's $250k Angel deckPitch Deck Teardown: Kinnect's $250k Angel deck
Pitch Deck Teardown: Kinnect's $250k Angel deck
HajeJanKamps

Zodiac Signs and Food Preferences_ What Your Sign Says About Your Taste
Zodiac Signs and Food Preferences_ What Your Sign Says About Your TasteZodiac Signs and Food Preferences_ What Your Sign Says About Your Taste
Zodiac Signs and Food Preferences_ What Your Sign Says About Your Taste
my Pandit

Satta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results Kalyan ChartSatta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results

Recently uploaded (20)

Cover Story - China's Investment Leader - Dr. Alyce SU
Cover Story - China's Investment Leader - Dr. Alyce SUCover Story - China's Investment Leader - Dr. Alyce SU
Cover Story - China's Investment Leader - Dr. Alyce SU

Industrial Tech SW: Category Renewal and Creation
Industrial Tech SW:  Category Renewal and CreationIndustrial Tech SW:  Category Renewal and Creation
Industrial Tech SW: Category Renewal and Creation

Part 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 SlowdownPart 2 Deep Dive: Navigating the 2024 Slowdown
Part 2 Deep Dive: Navigating the 2024 Slowdown

Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...
Unveiling the Dynamic Personalities, Key Dates, and Horoscope Insights: Gemin...

PM Surya Ghar Muft Bijli Yojana: Online Application, Eligibility, Subsidies &...
PM Surya Ghar Muft Bijli Yojana: Online Application, Eligibility, Subsidies &...PM Surya Ghar Muft Bijli Yojana: Online Application, Eligibility, Subsidies &...
PM Surya Ghar Muft Bijli Yojana: Online Application, Eligibility, Subsidies &...

Prescriptive analytics BA4206 Anna University PPT
Prescriptive analytics BA4206 Anna University PPTPrescriptive analytics BA4206 Anna University PPT
Prescriptive analytics BA4206 Anna University PPT

TIMES BPO: Business Plan For Startup Industry
TIMES BPO: Business Plan For Startup IndustryTIMES BPO: Business Plan For Startup Industry
TIMES BPO: Business Plan For Startup Industry

Digital Transformation Frameworks: Driving Digital Excellence
Digital Transformation Frameworks: Driving Digital ExcellenceDigital Transformation Frameworks: Driving Digital Excellence
Digital Transformation Frameworks: Driving Digital Excellence

Satta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results Kalyan ChartSatta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results Kalyan Chart

The Steadfast and Reliable Bull: Taurus Zodiac Sign
The Steadfast and Reliable Bull: Taurus Zodiac SignThe Steadfast and Reliable Bull: Taurus Zodiac Sign
The Steadfast and Reliable Bull: Taurus Zodiac Sign

IMG_20240615_091110.pdf dpboss guessing
IMG_20240615_091110.pdf dpboss  guessingIMG_20240615_091110.pdf dpboss  guessing
IMG_20240615_091110.pdf dpboss guessing

The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...
The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...
The APCO Geopolitical Radar - Q3 2024 The Global Operating Environment for Bu...

2022 Vintage Roman Numerals Men Rings
2022 Vintage Roman  Numerals  Men  Rings2022 Vintage Roman  Numerals  Men  Rings
2022 Vintage Roman Numerals Men Rings

AI Transformation Playbook: Thinking AI-First for Your Business
AI Transformation Playbook: Thinking AI-First for Your BusinessAI Transformation Playbook: Thinking AI-First for Your Business
AI Transformation Playbook: Thinking AI-First for Your Business

Science Around Us Module 2 Matter Around Us
Science Around Us Module 2 Matter Around UsScience Around Us Module 2 Matter Around Us
Science Around Us Module 2 Matter Around Us

How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....
How are Lilac French Bulldogs Beauty Charming the World and Capturing Hearts....

Discover the Beauty and Functionality of The Expert Remodeling Service
Discover the Beauty and Functionality of The Expert Remodeling ServiceDiscover the Beauty and Functionality of The Expert Remodeling Service
Discover the Beauty and Functionality of The Expert Remodeling Service

Pitch Deck Teardown: Kinnect's $250k Angel deck
Pitch Deck Teardown: Kinnect's $250k Angel deckPitch Deck Teardown: Kinnect's $250k Angel deck
Pitch Deck Teardown: Kinnect's $250k Angel deck

Zodiac Signs and Food Preferences_ What Your Sign Says About Your Taste
Zodiac Signs and Food Preferences_ What Your Sign Says About Your TasteZodiac Signs and Food Preferences_ What Your Sign Says About Your Taste
Zodiac Signs and Food Preferences_ What Your Sign Says About Your Taste

Satta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results Kalyan ChartSatta Matka Dpboss Kalyan Matka Results Kalyan Chart
Satta Matka Dpboss Kalyan Matka Results Kalyan Chart

Earned Value fundamentals

  • 1. Earned Value Management Fundamentals Welcome to the course
  • 2. Introduction Before getting started, please use the comments area below to introduce yourself (you’re colleagues want to meet you!) Tell us the business sector/industry you’re coming from, your company name if you like, your experience with project management so far and if you have ever been involved with the challenging world of Earned Value! What are your expectations from the course?
  • 3. Let’s get started! The ‘Earned Value Fundamentals’ is an introduction course to the Earned Value Management world (or the Project Controls world!) We take for granted that you know how to plan a project, develop the WBS and create activities taking into account the resources availability. You also know how to distribute the project budget. Purpose of the course is to understand the Schedule – Cost integration and learn how Earned Value will help you make realistic forecasts and get early warning signals that will support your decision making when planning preventive actions. Enjoy the course!
  • 5. Planning Executing Monitor & Control The Project Management lifecycle WBS Schedule - Critical Path Method Distribute Budget – Cost Profile Allocate Resources Project Baseline Record Progress / Actuals - Dates - Costs - Resources Results & Reporting Progress Changes Variances from the Baseline
  • 6. Planning WBS Schedule - Critical Path Method Distribute Budget – Cost Profile Allocate Resources Project Baseline Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline
  • 7. Planning WBS Critical Path Method Distribute Budget – Cost Profile Allocate Resources Project Baseline Executing Record Progress / Actuals - Dates - Costs - Resources Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline actual status date
  • 8. Planning WBS Critical Path Method Distribute Budget – Cost Profile Allocate Resources Project Baseline Executing Monitor & Control Results & Reporting Progress Changes Variances from the Baseline Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline actual status date
  • 9. Earned Value ElementsEarned Value ElementsEarned Value ElementsEarned Value Elements
  • 10. Planning Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline Project: Project: Replacement of pits and ducts along a 200m pavement. Project Duration: 25w Budgeted Cost: $250.000 Project Baseline:
  • 11. Planning Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline Project: Project: Replacement of pits and ducts along a 200m pavement. Project Duration: 25w Budgeted Cost: $250.000 Project Baseline: For training purposes, we shall focus on the first project activity that will guide us through the Earned Value Elements.
  • 12. Planning Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline Project: Project: Replacement of pits and ducts along a 200m pavement. Activity: Lay 50m of ducts Baseline Duration: 3weeks – 15days Baseline Cost: $10.000 Project Duration: 25w Budgeted Cost: $250.000 Project Baseline: Cost profile: Week 1: $3.000 Week 2: $5.000 Week 3: $2.000 $250,000
  • 13. Planning Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline Activity: Lay 50m of ducts Baseline Duration: 3weeks – 15days Baseline Cost: $10.000 Cost profile: Week 1: $3.000 Week 2: $5.000 Week 3: $2.000 $3.000 $8.000 $10.000 15m 40m 50m The schedule has been developed. The baseline is set. We have planned to lay 50m of ducts within 15 days. The budgeted cost is $10.000 and it is cumulatively distributed along the activity duration.
  • 14. Planning Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline Activity: Lay 50m of ducts Baseline Duration: 3weeks – 15days Baseline Cost: $10.000 Cost profile: Week 1: $3.000 Week 2: $5.000 Week 3: $2.000 $3.000 $8.000 $10.000 15m 40m 50m Budget At Completion (BAC): $10.000 Distribution over the activity duration Week 1: $3.000 Week 2: $5.000 Week 3: $2.000
  • 15. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m The schedule has been developed. The baseline is set and the BAC has been agreed. We have planned to lay 50m of ducts within 15 days. The baseline cost, is $10.000 and it is cumulatively distributed along the activity duration. The BAC is not standing alone. For each week of the activity a specific amount of work has been planned to be performed. Budget At Completion (BAC): $10.000 Period Cumulative $3.000 $3.000 $5.000 $8.000 $2.000 $10.000 Work Planned: 50m of ducts Period Cumulative Week 1: 15m 15m Week 2: 25m 40m Week 3: 10m 50m Activity Duration: 15d Period Cumulative 5d 5d 5d 10d 5d 15d
  • 16. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 01 02 03 04 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m One week later we update the project progress… The schedule has been developed. The baseline is set and the BAC has been agreed. We have planned to lay 50m of ducts within 15 days. The baseline cost, is $10.000 and it is cumulatively distributed along the activity duration. The BAC is not standing alone. For each week of the activity a specific amount of work has been planned to be performed.
  • 17. Executing Project Week Activity: Lay 50m of ducts Baseline Duration: 3weeks – 15days Baseline Cost: $10.000 Cost profile: Week 1: $3.000 Week 2: $5.000 Week 3: $2.000 We planned to lay 15meters within the first five days. However, one week later when the progress updated, only 10m were completed. The actual activity cost is so far $3.000. 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m
  • 18. Executing Project Week Activity: Lay 50m of ducts Baseline Duration: 3weeks – 15days Baseline Cost: $10.000 Cost profile: Week 1: $3.000 Week 2: $5.000 Week 3: $2.000 We planned to lay 15meters within the first five days. However, one week later when the progress updated, only 10m were completed. The actual activity cost is so far $3.000. 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m Actual Cost (AC) on Week 1: $3.000 Actual Cost is the cost of work performed by the day the progress updated. It’s not necessarily the cost that has been paid to the contractor.
  • 19. Executing Project Week Activity: Lay 50m of ducts Baseline Duration: 3weeks – 15days Baseline Cost: $10.000 Cost profile: Week 1: $3.000 Week 2: $5.000 Week 3: $2.000 We planned to lay 15meters within the first five days. However, one week later when the progress updated, only 10m were completed. The actual activity cost is so far $3.000. 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m Actual Cost (AC) on Week 1: $3.000 Actual Cost is the cost of work performed by the day the progress updated. It’s not necessarily the cost that has been paid to the contractor. You may also see the AC as Actual Cost of Work Performed (ACWP). The Actual Cost, or Actual Cost of Work Performed (ACWP) consists of: Actual [Labor + Non labor (equipment and machinery) + Material (the cost of ducts) + Expenses (like training, but expenses do not apply to all the project activities)]
  • 20. Executing Project Week Activity: Lay 50m of ducts Baseline Duration: 3weeks – 15days Baseline Cost: $10.000 Cost profile: Week 1: $3.000 Week 2: $5.000 Week 3: $2.000 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m Actual Cost (AC) on Week 1: $3.000 Actual Cost is the cost of work performed by the day the progress updated. It’s not necessarily the cost that has been paid to the contractor. Week 1 Planned Actual Work 15m 10m Cost $3.000 $3.000
  • 21. Project Week How is the project doing? 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m Question:
  • 22. Project Week How is the project doing? 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m Question:
  • 23. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done?
  • 24. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: Budget At Completion (BAC): $10.000 Period Cumulative $3.000 $3.000 $5.000 $8.000 $2.000 $10.000 Work Planned: 50m of ducts Period Cumulative Week 1: 15m 15m Week 2: 25m 40m Week 3: 10m 50m Activity Duration: 15d Period Cumulative 5d 5d 5d 10d 5d 15d Planned Value Cost (PVC) or Budgeted Cost of Work Scheduled (BCWS) How much work should have been done at the end of week 1? Planned Value is the target against which we are measuring the progress How much work should have been done so far? How much did the work cost? How much work has been actually done?
  • 25. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: Budget At Completion (BAC): $10.000 Period Cumulative $3.000 $3.000 $5.000 $8.000 $2.000 $10.000 Work Planned: 50m of ducts Period Cumulative Week 1: 15m 15m Week 2: 25m 40m Week 3: 10m 50m Activity Duration: 15d Period Cumulative 5d 5d 5d 10d 5d 15d Planned Value Cost (PVC) or Budgeted Cost of Work Scheduled (BCWS) How much work should have been done at the end of week 1? Planned Value is the target against which we are measuring the progress Planned Value Cost at the end of Week 1 How much work should have been done so far? How much did the work cost? How much work has been actually done?
  • 26. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: Budget At Completion (BAC): $10.000 Period Cumulative $3.000 $3.000 $5.000 $8.000 $2.000 $10.000 Work Planned: 50m of ducts Period Cumulative Week 1: 15m 15m Week 2: 25m 40m Week 3: 10m 50m Activity Duration: 15d Period Cumulative 5d 5d 5d 10d 5d 15d PVC = BAC x Planned % Complete Planned Value Cost at the end of Week 1 We planned to complete 30% of the Budget At Completion ($10.000) at the end of the week 1. PVC = $10.000 x 30% = $3.000 How much work should have been done so far? How much did the work cost? How much work has been actually done?
  • 27. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Budget At Completion (BAC): $10.000 Period Cumulative $3.000 $3.000 $5.000 $8.000 $2.000 $10.000 Work Planned: 50m of ducts Period Cumulative Week 1: 15m 15m Week 2: 25m 40m Week 3: 10m 50m Activity Duration: 15d Period Cumulative 5d 5d 5d 10d 5d 15d PVC = BAC x Planned % Complete Planned Value Cost at the end of Week 1 We planned to complete 30% of the Budget At Completion ($10.000) at the end of the week 1. PVC = $10.000 x 30% = $3.000 PVC = $10.000 x 30% = $3.000
  • 28. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Actual Cost (AC) is the Actual Cost of Work Performed until the status date (you may also see ACWP). The Actual Cost of the work at the end of the week1 is $3.000. PVC = $10.000 x 30% = $3.000
  • 29. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Actual Cost (AC) is the Actual Cost of Work Performed until the status date (you may also see ACWP). The Actual Cost of the work at the end of the week1 is $3.000. PVC = $10.000 x 30% = $3.000 AC= $3.000
  • 30. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Actual Cost (AC) is the Actual Cost of Work Performed until the status date (you may also see ACWP). The Actual Cost of the work at the end of the week1 is $3.000. PVC = $10.000 x 30% = $3.000 AC= $3.000 It doesn’t look that bad, right?
  • 31. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Earned Value (EV) signifies how much work has been actually done. To measure the EV we need to know: - BAC - Performance % Complete EV = BAC x Performance % Complete PVC = $10.000 x 30% = $3.000 AC= $3.000
  • 32. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Earned Value (EV) signifies how much work has been actually done. To measure the EV we need to know: - BAC - Performance % Complete EV = BAC x Performance % Complete PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete We planned to perform 15m at the end of week 1 which is the 33,33% of the total work. However, we performed only 10m, which the 20% of the total work. EV = $10.000 x 20% = $2.000
  • 33. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Earned Value (EV) signifies how much work has been actually done. To measure the EV we need to know: - BAC - Performance % Complete EV = BAC x Performance % Complete PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete We planned to perform 15m at the end of week 1 which is the 33,33% of the total work. However, we performed only 10m, which the 20% of the total work. EV = $10.000 x 20% = $2.000 EV = $10.000 x 20% = $2.000
  • 34. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Earned Value (EV) signifies how much work has been actually done. To measure the EV we need to know: - BAC - Performance % Complete EV = BAC x Performance % Complete PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete We planned to perform 15m at the end of week 1 which is the 33,33% of the total work. However, we performed only 10m, which the 20% of the total work. EV = $10.000 x 20% = $2.000 EV = $10.000 x 20% = $2.000
  • 35. Monitor & Control Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m How is the project doing? Question: How much work should have been done so far? How much did the work cost? How much work has been actually done? Earned Value (EV) signifies how much work has been actually done. To measure the EV we need to know: - BAC - Performance % Complete EV = BAC x Performance % Complete PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete EV = $10.000 x 20% = $2.000 Earned Value explains whether the Actual Cost (AC) has been spent effectively (Performance % Complete) providing the physical results that was estimated to (Planned Value).
  • 36. How is the project doing? Question: Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete EV = $10.000 x 20% = $2.000 Earned Value explains whether the Actual Cost (AC) has been spent effectively (Performance % Complete) delivering the physical results that was estimated to (Planned Value). The project is not doing very well… Here are the facts: Answer: PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = $10.000 x 20% = $2.000
  • 37. Earned Value elements within the Project Management lifecycle Planning Executing Closing Monitor & Control Planned Value Cost Actual Cost Earned Value Initiating EV = BAC x Performance % CompletePVC = BAC x Planned % Complete
  • 38. Earned Value elements within the Project Management lifecycle Planning Executing Closing Monitor & Control Planned Value Cost Actual Cost Earned Value Initiating BCWP: Budgeted Cost of Work Performed BCWS: Budgeted Cost of Work Scheduled ACWP: Actual Cost of Work Performed
  • 39. Earned Value elements within the Project Management lifecycle Planning Executing Closing Monitor & Control Planned Value Cost Actual Cost Earned Value Initiating BCWP: Budgeted Cost of Work Performed BCWS: Budgeted Cost of Work Scheduled ACWP: Actual Cost of Work Performed Why two terms for the same thing?
  • 40. Earned Value elements within the Project Management lifecycle Planning Executing Closing Monitor & Control Planned Value Cost Actual Cost Earned Value Initiating BCWP: Budgeted Cost of Work Performed BCWS: Budgeted Cost of Work Scheduled ACWP: Actual Cost of Work Performed Why two terms for the same thing? New term !
  • 41. Earned Value elements within the Project Management lifecycle Planning Executing Closing Monitor & Control Planned Value Cost Actual Cost Earned Value Initiating BCWP: Budgeted Cost of Work Performed BCWS: Budgeted Cost of Work Scheduled ACWP: Actual Cost of Work Performed Why two terms for the same thing? New term ! Old term !
  • 42. Earned Value elements within the Project Management lifecycle Planning Executing Closing Monitor & Control Planned Value Cost Actual Cost Earned Value Initiating BCWP: Budgeted Cost of Work Performed BCWS: Budgeted Cost of Work Scheduled ACWP: Actual Cost of Work Performed Why two terms for the same thing? New term ! Old term ! Both correct and both in use!
  • 43. Measuring the Earned Value the Performance % Complete type EV = BAC x Performance % Complete
  • 44. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m Earned value is all about measuring the work performed. The Performance % Complete should provide realistic and tangible information for the project’s progress. It is selected during the project planning and can be different for each Work Package. Althouth there are several methods in this course we focus in three methods, proven to be best practices. PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete Performance % Complete Percent Complete Estimates Weighted Milestones Fixed Formula EV = $10.000 x 20% = $2.000 Performance % Complete
  • 45. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m Percent Complete Estimates PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete EV = $10.000 x 20% = $2.000 Performance % Complete It's the most commonly used measurement method as it's easy to administer within the already complex project environment. However it is subjective and often relies on the project manger's perspective. Expert judgment, experience and comprehensive understanding of the project scope are the requirements to maximize the benefits of the % complete estimates in the project.
  • 46. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m Percent Complete Estimates PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete EV = $10.000 x 20% = $2.000 Performance % Complete It's the most commonly used measurement method as it's easy to administer within the already complex project environment. However it is subjective and often relies on the project manger's perspective. Expert judgment, experience and comprehensive understanding of the project scope are the requirements to maximize the benefits of the % complete estimates in the project. However, it can be less subjective when tangible measurement is involved; like in our example the meters of the pits and ducts planned to complete per week (or per reporting period).
  • 47. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline Weighted Milestones PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete EV = $10.000 x 20% = $2.000 Performance % Complete The planned work is divided into segments. Each Weighted Milestone represents the percent of the work planned to be achieved within the period. You can use it for work packages that exceed one measurement period. The milestone values should be set before the work starts. The challenge is to agree on the values and make it clear to everyone involved what the values represent. 25% 60% 100%
  • 48. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline Fixed Formula PVC = $10.000 x 30% = $3.000 AC= $3.000 EV = BAC x Performance % Complete EV = $10.000 x 20% = $2.000 Performance % Complete It can be used in short duration activities. Once the work starts, the 50% of the work is considered as completed. At the end of it the 100% is completed. Other examples are: 10/90 25/75 0/100 50% 100% 50/50
  • 49. Forecasting the project’s future using EVM
  • 50. Forecasting the project’s future using EVM it's time to get some meaningful results from the project and try to forecast the future of the project realistically
  • 51. Forecasting the project’s future using EVM it's time to get some meaningful results from the project and try to forecast the future of the project realistically Estimate To Complete
  • 52. How can we estimate the cost left to perform until the completion of the activity? Question: Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 Estimate To Complete cost ETC: Answer: ETC = Remaining cost of work (40m*$200/m) ETC = $8.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 PVC = $10.000 x 30% = $3.000
  • 53. How can we estimate the cost left to perform until the completion of the activity? Question: Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 Why do we Estimate To Complete? Because the remaining cost of work is not always fixed. It may vary depending on several factors, like additional changes that may change the budget. Perhaps we will be able to complete the activity earlier and therefore cost less, or later than planned, or use more resources which causes increased cost. EV = $10.000 x 20% = $2.000 Estimate To Complete cost ETC: Answer: PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 PVC = $10.000 x 30% = $3.000 ETC = Remaining cost of work (40m*$200/m) ETC = $8.000
  • 54. Forecasting the project’s future using EVM it's time to get some meaningful results from the project and try to forecast the future of the project realistically Estimate At Completion
  • 55. So, at the end of the activity how much will it cost? Question: Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 Why do we Estimate At Completion? Because the variable used to forecast the cost at the completion of the activity/project is the ETC. Therefore, is not a fixed figure and can be adjusted in the future. EV = $10.000 x 20% = $2.000 The Estimate At Completion cost EAC: Answer: EAC = ETC + AC EAC = $8.000 + $3.000 = $11.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $8.000 PVC = $10.000 x 30% = $3.000
  • 56. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $11.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $8.000 PVC = $10.000 x 30% = $3.000
  • 57. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $11.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $8.000 PVC = $10.000 x 30% = $3.000 How is Earned Value involved with all this?
  • 58. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $11.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $8.000 PVC = $10.000 x 30% = $3.000 Earned Value and Cost Performance
  • 59. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $11.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $8.000 PVC = $10.000 x 30% = $3.000 Don’t forget that our activity is already underperforming. The ETC and EAC reflect the current status of the activity/project. However, at this point they don’t include the cost of delay or underperformance. Identifying the cost variance between the AC and EV enable us a more realistic picture of the activity performance at the current time period.
  • 60. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $11.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $8.000 PVC = $10.000 x 30% = $3.000 Cost Variance (CV) = EV - AC CV = $2.000 - $3.000 = $-1.000 CV = $-1.000
  • 61. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $10.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $7.000 PVC = $10.000 x 30% = $3.000 CV = $-1.000 Which is the relationship between the AC and the EV? Cost Performance Index (CPI) = EV / AC CPI = $2.000 / $3.000 = 0.67
  • 62. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $10.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $7.000 PVC = $10.000 x 30% = $3.000 CV = $-1.000 Which is the relationship between the AC and the EV? Cost Performance Index (CPI) = EV / AC CPI = $2.000 / $3.000 = 0.67 In simple terms, for each dollar spent, only 0.67 worth paying! CPI = 0.67
  • 63. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $10.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $7.000 PVC = $10.000 x 30% = $3.000 Earned Value and Schedule Performance CV = $-1.000 CPI = 0.67
  • 64. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $10.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $7.000 PVC = $10.000 x 30% = $3.000 CV = $-1.000 CPI = 0.67 As with the CV, we want to identify and compare the work planned to perform within a time period with the work accomplished. The Schedule Variance (SV) will provide us with the right information. It is expressed in in monetary values. SV = EV – PV SV = $2.000 - $3.000 = $-1.000 SV = $-1.000
  • 65. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $10.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $7.000 PVC = $10.000 x 30% = $3.000 CV = $-1.000 CPI = 0.67 SV = $-1.000 How the Planned and the Earned Value are related? Schedule Performance Index (SPI) = EV / PV SPI = $2.000 / $3.000 = 0.67
  • 66. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $10.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $7.000 PVC = $10.000 x 30% = $3.000 CV = $-1.000 CPI = 0.67 SV = $-1.000 How the Planned and the Earned Value are related? Schedule Performance Index (SPI) = EV / PV SPI = $2.000 / $3.000 = 0.67 SPI = 0.67
  • 67. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m AC= $3.000 EV = $10.000 x 20% = $2.000 EAC = $10.000 PVC = $3.000 AC = $3.000 EV = $2.000 BAC = $10.000 ETC = $7.000 PVC = $10.000 x 30% = $3.000 CV = $-1.000 CPI = 0.67 SV = $-1.000 CPI, SPI rule: CPI > 1 more work done than what actually paid for. CPI = 1 you got exactly what you paid for. CPI < 1 less work done than what actually paid for. SPI > 1 - ahead of schedule. The work accomplished is more that the work planned. SPI = 1 - the work accomplished is exactly the work planned. SPI < 1 - behind schedule. The work accomplished is less than planned. SPI = 0.67
  • 69. Reporting Earned Value Now that we know what Earned Value means, how it’s used and why it can make a big difference in a project, we need to know how to present and report data.
  • 70. Reporting Earned Value Now that we know what Earned Value means, how it’s used and why it can make a big difference in a project, we need to know how to present and report data. Tables and diagrams help to communicate the message clearly and can be used in meetings for decision making.
  • 71. Reporting Earned Value Now that we know what Earned Value means, how it’s used and why it can make a big difference in a project, we need to know how to present and report data. Tables and diagrams help to communicate the message clearly and can be used in meetings for decision making. The Earned Value data are reported cumulatively. The cumulative data represent a comprehensive project picture as they incorporate the overall project performance up to date.
  • 72. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m PVC AC EV BAC: Activity: Lay 50m of ducts Week 1 ETC CV $10.000 $3.000 $3.000 $2.000 $8.000 $11.000 $-1.000 SV $-1.000 EAC 35m $9.000 The first reporting period (week 1) we have the following results: Back to our example
  • 73. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m BAC: Activity: Lay 50m of ducts Week 1 $10.000 35m $9.000 1 0.5 1.5 0.67 0.67 CPI SPI W1 The first reporting period (week 1) we have the following results: PVC AC EV ETC CV $3.000 $3.000 $2.000 $8.000 $11.000 $-1.000 SV $-1.000 EAC
  • 74. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m BAC: Activity: Lay 50m of ducts Week 1 $10.000 35m $9.000 1 0.5 1.5 0.67 0.67 CPI SPI W1 The second reporting period (week 2) the activity performance is: PVC AC EV ETC CV $3.000 $3.000 $2.000 $8.000 $11.000 $-1.000 SV $-1.000 EAC
  • 75. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m PVC AC EV BAC: Activity: Lay 50m of ducts Week 1 Week 2 ETC CV $10.000 $3.000 $3.000 $2.000 $8.000 $11.000 $-1.000 $8.000 $9.000 $7.000 $3.000 $12.000 $-2.000 SV $-1.000 $-1.000 EAC 35m $9.000 1 0.5 1.5 0.67 0.67 CPI SPI W1 The second reporting period (week 2) the activity performance is:
  • 76. Project Week 10 11 12 13 14 15 16 17 18 19 20 21 22 23 24 25 26 27 28 29 30 31 32080401020304 03 0401 02 05 06 07 09 planned baseline$3.000 $8.000 $10.000 15m 40m 50m 10m PVC AC EV BAC: Activity: Lay 50m of ducts Week 1 Week 2 ETC CV $10.000 $3.000 $3.000 $2.000 $8.000 $11.000 $-1.000 $8.000 $9.000 $7.000 $3.000 $12.000 $-2.000 SV $-1.000 $-1.000 EAC 35m $9.000 1 0.5 1.5 0.67 0.78 0.67 0.87 CPI SPI W1 W2 The second reporting period (week 2) the activity performance is:
  • 77. Reporting Earned Value When reporting Earned Value, consistency is everything! Only when the reporting periods are relevant you can get meaningful reports!
  • 78. Thanks for attending EVM Fundamentals! Denise Fotopoulou
