Earned	Value
Management
Earned	Value	Management	topic	from	Control	Cost	– Cost	Management
BY	– Dilip Chaturvedi,	PMP
Email	Id	:	info@justpmp.com
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	IncConfidential	 and	Copyrighted	 material	of	JustPMP

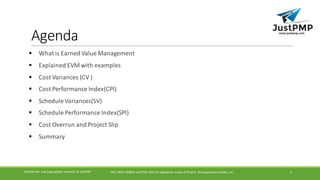

Agenda
§ What	is	Earned	Value	Management
§ Explained	EVM	with	examples
§ Cost	Variances	(CV	)
§ Cost	Performance	Index(CPI)
§ Schedule	Variances(SV)
§ Schedule	Performance	Index(SPI)
§ Cost	Overrun	and	Project	Slip
§ Summary
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	IncConfidential	 and	Copyrighted	 material	of	JustPMP 2

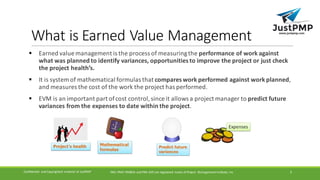

What	is	Earned	Value	Management
§ Earned	value	management	is	the	process	of	measuring	the	performance	of	work	against
what	was	planned	to	identify	variances,	opportunities	to	improve	the	project	or	just	check
the	project	health’s.
§ It	is	system	of	mathematical	formulas	that	compares	work	performed	against	work	planned,
and	measures	the	cost	of	the	work	the	project	has	performed.
§ EVM	is	an	important	part	of	cost	control,	since	it	allows	a	project	manager	to	predict	future
variances	from	the	expenses	to	date	within	the	project.
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	IncConfidential	 and	Copyrighted	 material	of	JustPMP 3

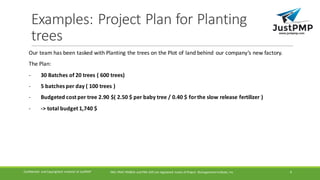

Examples:	Project	Plan	for	Planting
trees
Our	team	has	been	tasked	with	Planting	the	trees	on	the	Plot	of	land	behind	 our	company’s	new	factory.
The	Plan:
- 30	Batches	of	20	trees	(	600	trees)
- 5	batches	per	day	(	100	trees	)
- Budgeted	cost	per	tree	2.90	$(	2.50	$	per	baby	tree	/	0.40	$	for	the	slow	release	fertilizer	)
- ->	total	budget	1,740	$
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	IncConfidential	 and	Copyrighted	 material	of	JustPMP 4

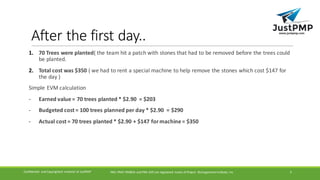

After	the	first	day..
1. 70	Trees	were	planted(	the	team	hit	a	patch	with	stones	that	had	to	be	removed	before	the	trees	could
be	planted.
2. Total	cost	was	$350	(	we	had	to	rent	a	special	machine	to	help	remove	the	stones	which	cost	$147	for
the	day	)
Simple	EVM	calculation
- Earned	value	=	70	trees	planted	*	$2.90		=	$203
- Budgeted	cost	=	100	trees	planned	per	day	*	$2.90		=	$290
- Actual	cost	=	70	trees	planted	*	$2.90	+	$147	for	machine	=	$350
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	IncConfidential	 and	Copyrighted	 material	of	JustPMP 5

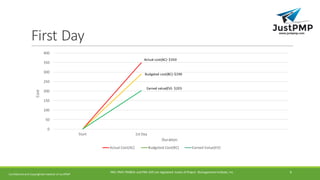

First	Day
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost(AC) Budgeted	Cost(BC) Earned	Value(EV)
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
Confidential	and	Copyrighted	material	of	JustPMP
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 6

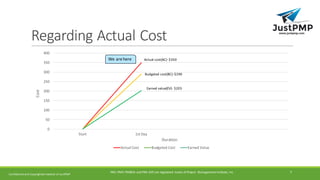

Regarding	Actual	Cost
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost Budgeted	Cost Earned	Value
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
We	are	here
Confidential	and	Copyrighted	material	of	JustPMP
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 7

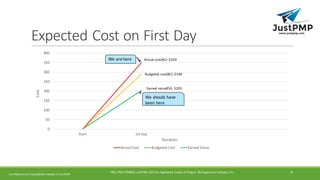

Expected	Cost	on	First	Day
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost Budgeted	Cost Earned	Value
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
We	are	here
We	should	have
been	here
Confidential	and	Copyrighted	material	of	JustPMP
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 8

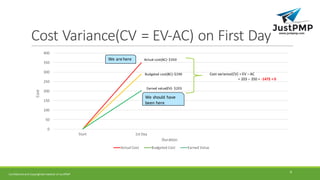

Cost	Variance(CV	=	EV-AC)	on	First	Day
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost Budgeted	Cost Earned	Value
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
We	are	here
We	should	have
been	here
Cost	variance(CV)	=	EV	– AC
=	203	– 350	=	-147$	<	0
Confidential	and	Copyrighted	material	of	JustPMP
9

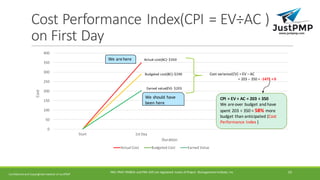

Cost	Performance	Index(CPI	=	EV÷AC	)
on	First	Day
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost Budgeted	Cost Earned	Value
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
We	are	here
We	should	have
been	here
Cost	variance(CV)	=	EV	– AC
=	203	– 350	=	-147$	<	0
CPI	=	EV	÷ AC	=	203	÷ 350
We	are	over	budget	and	have
spent	203	÷ 350	=	58%	more
budget	than	anticipated	(Cost
Performance	Index	)
Confidential	and	Copyrighted	material	of	JustPMP
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 10

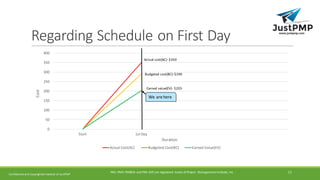

Regarding	Schedule	on	First	Day
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost(AC) Budgeted	Cost(BC) Earned	Value(EV)
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
We	are	here
Confidential	and	Copyrighted	material	of	JustPMP
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 11

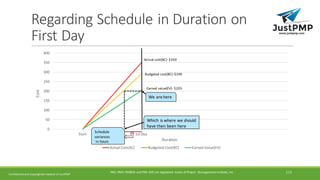

Regarding	Schedule	in	Duration	on
First	Day
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost(AC) Budgeted	Cost(BC) Earned	Value(EV)
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
We	are	here
Schedule
variances
in	hours
Confidential	and	Copyrighted	material	of	JustPMP
Which	is	where	we	should
have	then	been	here
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 112
Schedule	Variances(	SV	=	EV	- BC	)	on
First	Day
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost(AC) Budgeted	Cost(BC) Earned	Value(EV)
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
We	are	here
Schedule
variances
in	hours
Schedule	variance(SC)	in	dollars	=	EV	– BC
=	203	– 290	=	-87$	<	0
Confidential	and	Copyrighted	material	of	JustPMP
Which	is	where	we	should
have	then	been	here
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 13
Schedule	Performance	Index
(SPI	=	EV÷ BC	)	on	First	Day
0
50
100
150
200
250
300
350
400
Start 1st	Day
Cost
Duration
Actual	Cost(AC) Budgeted	Cost(BC) Earned	Value(EV)
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
We	are	here
Schedule
variances
in	hours
Schedule	variance(SC)	in	dollars	=	EV	– BC
=	203	– 290	=	-87$	<	0
Confidential	and	Copyrighted	material	of	JustPMP
Which	is	where	we	should
have	then	been	here
SPI	=	EV	÷ BC	=	203	÷ 290
We	are	late	and	have	only
performed		203	÷ 290	=	70%	of
the	work	planned	(	Our Schedule
Performance	Index	)
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 14
The	Consequences..	Cost	Overrun
0
500
1000
1500
2000
2500
3000
3500
Start 1st	Day 2nd	Day 3rd	Day 4th	Day 5th	Day 6th	Day 7th	Day 8th	Day 9th	Day
Cost
Duration
Actual	Cost(AC) Budgeted	Cost(BC) Earned	Value(EV)
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
Confidential	and	Copyrighted	material	of	JustPMP
Estimate	at
completion(EAC)	=
$	3000
Budget	at	completion
BAC	=		$	1740
Cost	Overrun
Planned	end	date
=	6	days
Estimate	at	completion
=	8.57	days
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 15

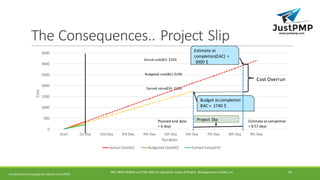

The	Consequences..	Project	Slip
0
500
1000
1500
2000
2500
3000
3500
Start 1st	Day 2nd	Day 3rd	Day 4th	Day 5th	Day 6th	Day 7th	Day 8th	Day 9th	Day
Cost
Duration
Actual	Cost(AC) Budgeted	Cost(BC) Earned	Value(EV)
Actual	cost(AC)- $350
Budgeted	cost(BC)-$290
Earned	value(EV)- $203
Project	Slip
Confidential	and	Copyrighted	material	of	JustPMP
Estimate	at
completion(EAC)	=
3000	$
Budget	at	completion
BAC	=		1740	$
Cost	Overrun
Planned	end	date
=	6	days
Estimate	at	completion
=	8.57	days
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 16

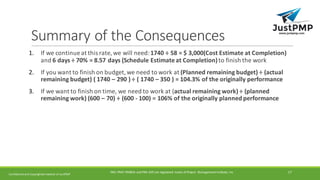

Summary	of	the	Consequences
1. If	we	continue	at	this	rate,	we	will	need:	1740	÷ 58	=	$	3,000(Cost	Estimate	at	Completion)
and	6	days	÷ 70%	=	8.57	days	(Schedule	Estimate	at	Completion)to	finish	the	work
2. If	you	want	to	finish	on	budget,	we	need	to	work	at	(Planned	remaining	budget)	÷ (actual
remaining	budget)	(	1740	– 290	)	÷ (	1740	– 350	)	=	104.3%	of	the	originally	performance
3. If	we	want	to	finish	on	time,	we	need	to	work	at	(actual	remaining	work)	÷ (planned
remaining	work)	(600	– 70)	÷ (600	- 100)	=	106%	of	the	originally	planned	performance
Confidential	and	Copyrighted	material	of	JustPMP
PMI,	PMP,	PMBOK	and	PMI-ACP	are	registered	 marks	of	Project	 Management	Institute,	Inc 17

In	technical	terms…
1. In	real	life,	the	elements	we	calculated	have	slightly	different	names:
2. The	Actual	Cost	is	usually	referred	to	as	Actual	Cost	of	Works	Performed(ACWP)
3. The	Planned	Cost	=	Budgeted	Cost	for	Work	Schedules(BCWS)
4. The	Earned	Value	=	Budgeted	Cost	for	Work	Performed	(BCWP)
Confidential	and	Copyrighted	material	of	JustPMP
