This document provides an overview of earned value management (EVM) with the following key points:

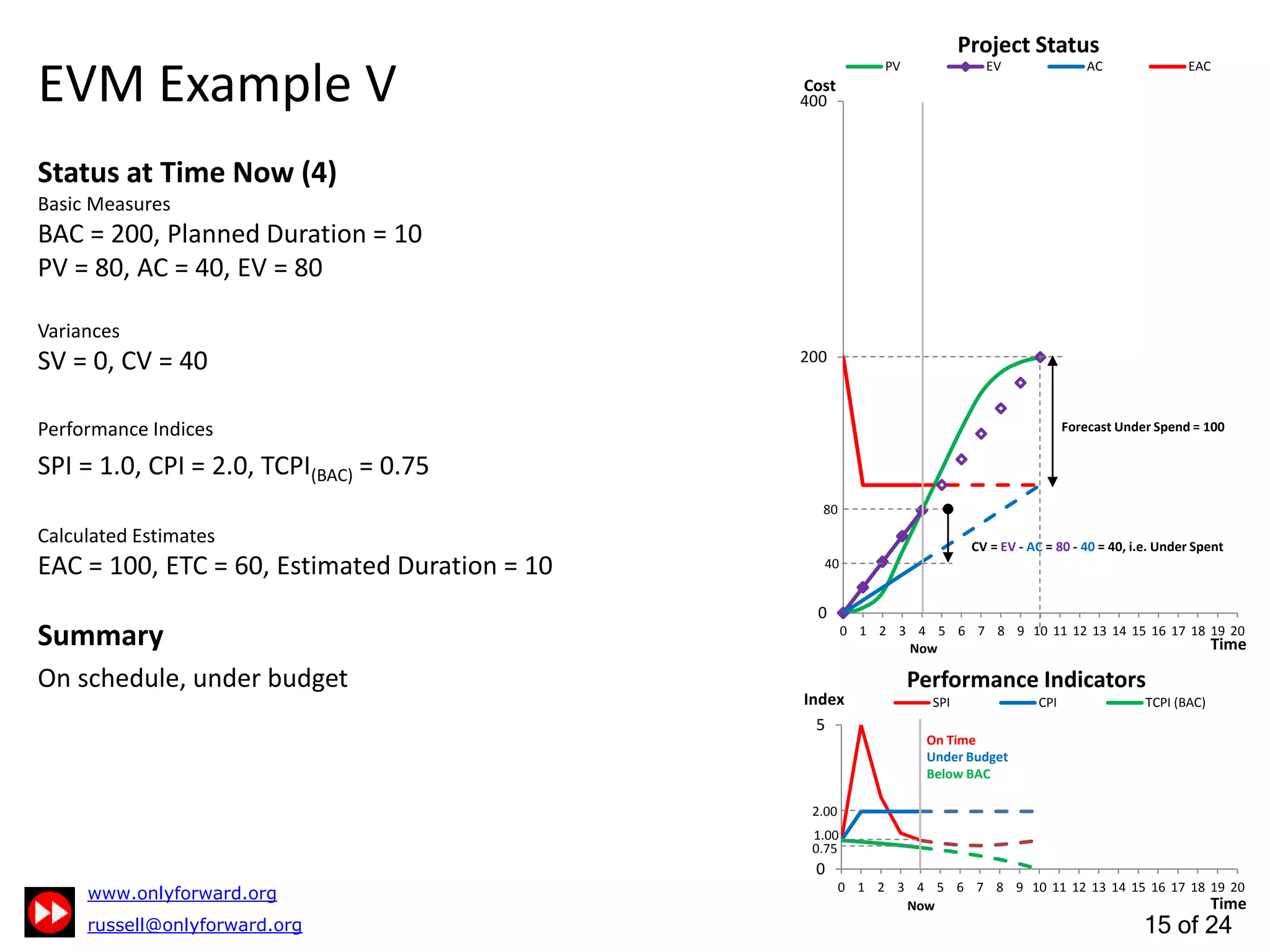

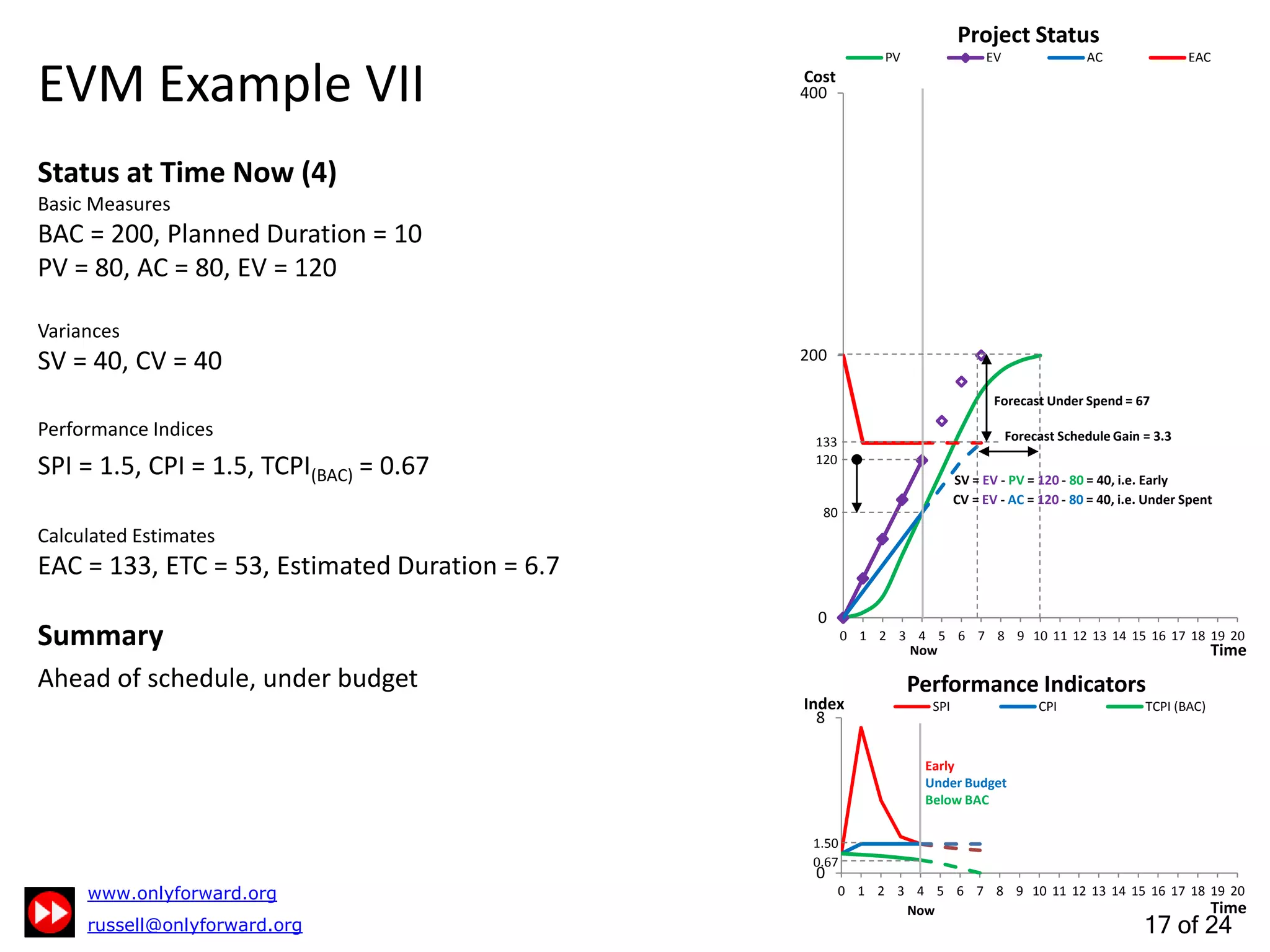

1. EVM is a project control process that facilitates integrating project scope, time, and cost objectives by comparing the planned value, actual cost, and earned value.

2. EVM improves project predictability, provides early warnings of problems, and objectively assesses value delivered versus costs through structured planning and performance measurement.
3. EVM uses variances, performance indices, and forecasting to monitor project performance and status in terms of schedule, budget, and estimates to completion. Positive variances and indices above 1 indicate favorable performance while negative or below 1 need corrective action.
