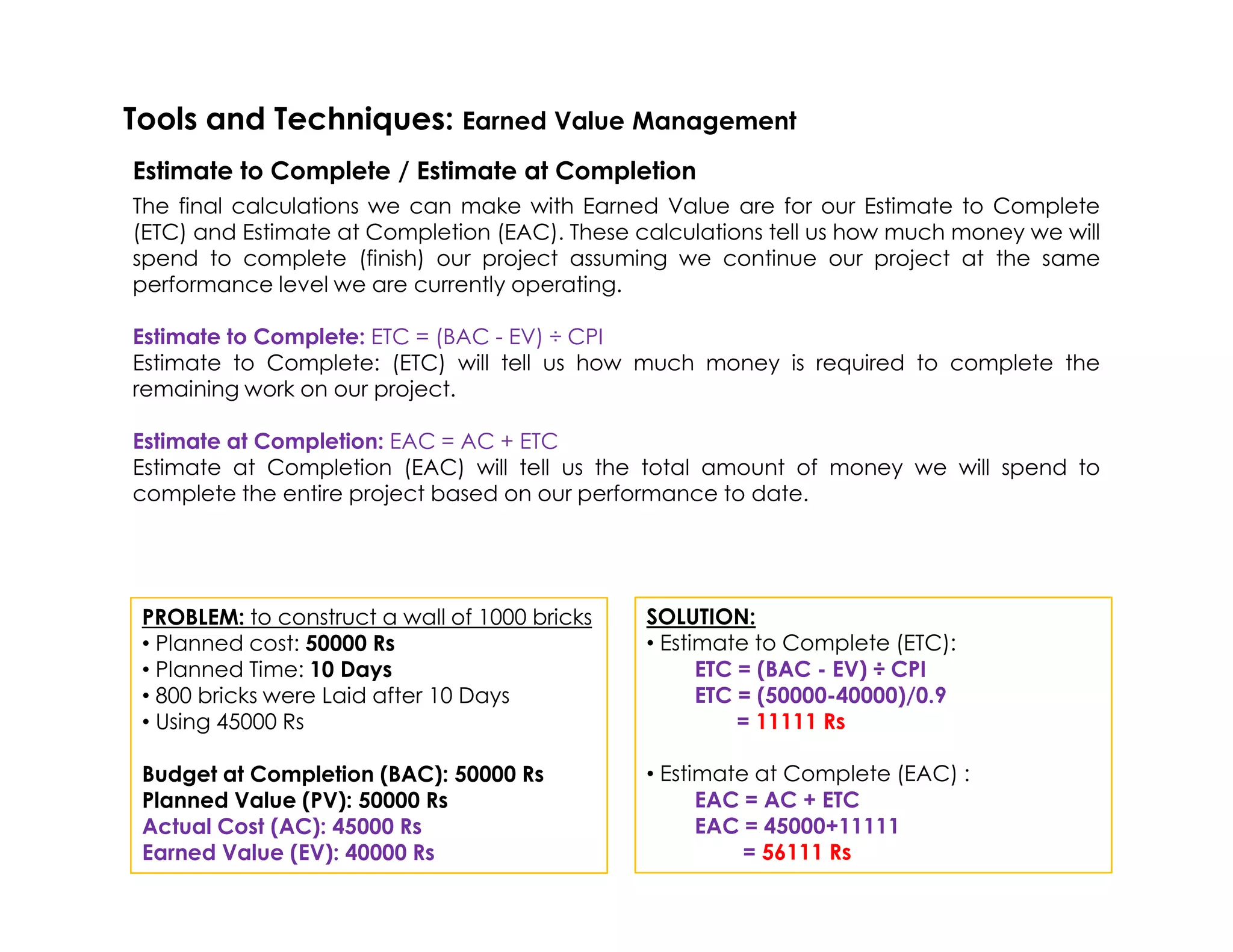

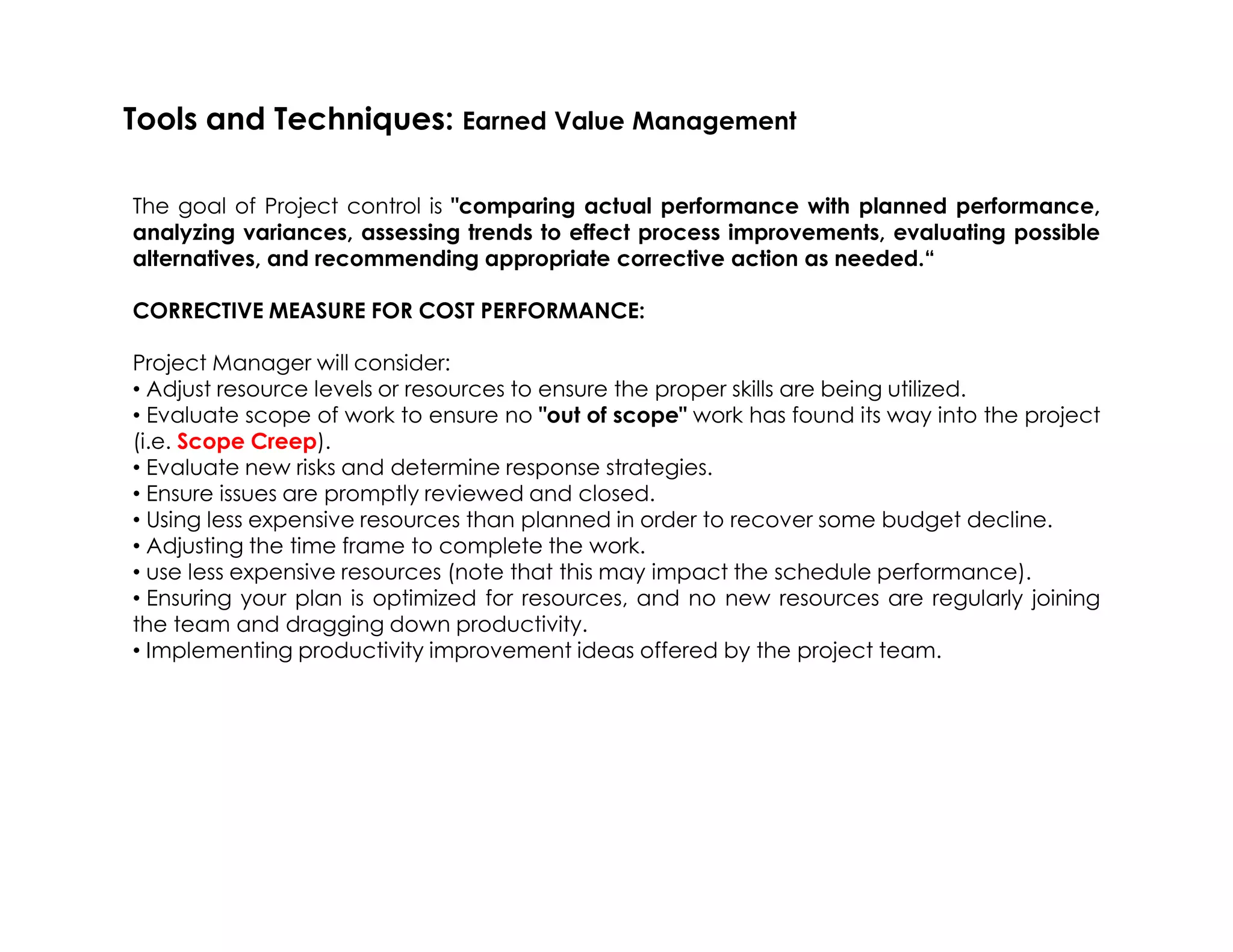

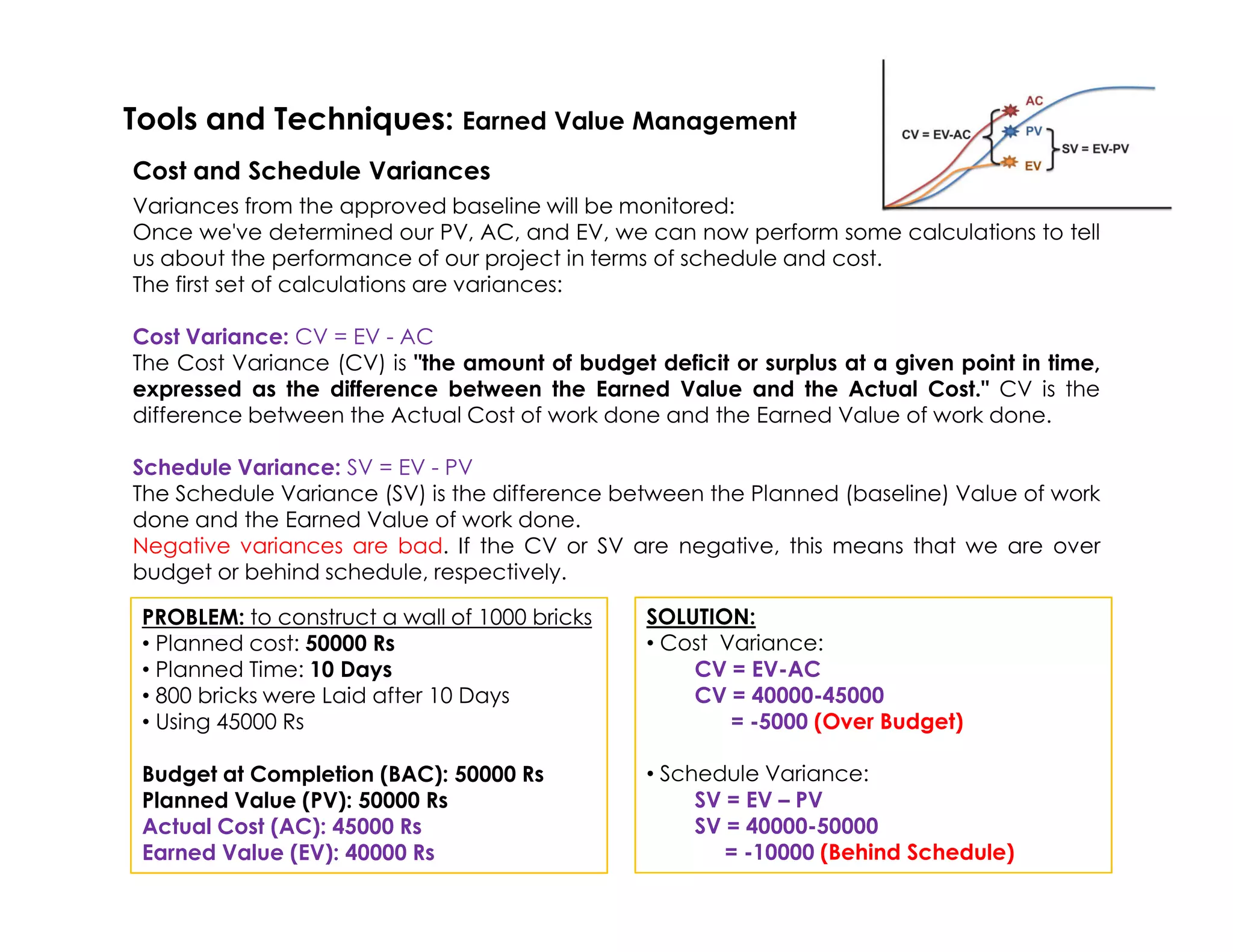

The document discusses earned value management (EVM), which combines measurements of project scope, schedule, and resources to assess performance and progress. EVM integrates the scope, cost, and schedule baselines to form a performance baseline for evaluation. Key EVM terms are defined, including planned value, actual cost, earned value, and budget at completion. Variances, performance indices, estimates to complete, and estimates at completion are calculated using EVM data. Corrective actions for cost performance issues may include adjusting resources, evaluating scope creep, and ensuring prompt issue resolution.
