Earned Value Management in Action
Vivek Prakash – Aug, 16, 2012

© 2012 pmwares – All rights reserved
Earned Value Management

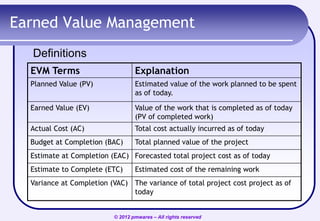

Definitions
EVM Terms

Explanation

Planned Value (PV)

Estimated value of the work planned to be spent
as of today.

Earned Value (EV)

Value of the work that is completed as of today
(PV of completed work)

Actual Cost (AC)

Total cost actually incurred as of today

Budget at Completion (BAC)

Total planned value of the project

Estimate at Completion (EAC) Forecasted total project cost as of today
Estimate to Complete (ETC)

Estimated cost of the remaining work

Variance at Completion (VAC) The variance of total project cost project as of
today
© 2012 pmwares – All rights reserved
Earned Value Management

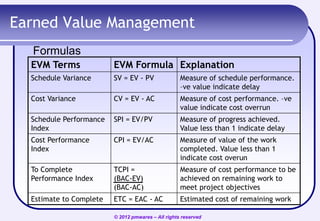

Formulas
EVM Terms

EVM Formula Explanation

Schedule Variance

SV = EV - PV

Measure of schedule performance.
–ve value indicate delay

Cost Variance

CV = EV - AC

Measure of cost performance. –ve
value indicate cost overrun

Schedule Performance
Index

SPI = EV/PV

Measure of progress achieved.
Value less than 1 indicate delay

Cost Performance
Index

CPI = EV/AC

Measure of value of the work
completed. Value less than 1
indicate cost overun

To Complete
Performance Index

TCPI =
(BAC-EV)
(BAC-AC)

Measure of cost performance to be
achieved on remaining work to
meet project objectives

Estimate to Complete

ETC = EAC - AC

Estimated cost of remaining work

© 2012 pmwares – All rights reserved
Earned Value Management
Formulas
EVM Terms EVM Formula

Explanation

Variance at
Completion

VAC = BAC - EAC

Variance of total projected cost from
budget

AC + Bottom up ETC

When original estimates are
fundamentally flawed

BAC
Cumulative CPI

Observing no variance, will continue
with same expenditure rate

AC + (BAC-EV)

Variance observed as of now will not be
observed in future. Will complete the
project in remaining budget

Estimate at
Completion
(EAC)

AC + [(BAC-EV)/
Current variance trends will continue.
(Cum.CPI x Cum.SPI)] Remaining budget is modified with cost
and schedule performance

© 2012 pmwares – All rights reserved

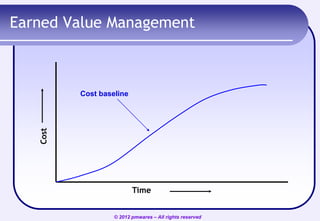

Earned Value Management

Cost

Cost baseline

Time
© 2012 pmwares – All rights reserved
Earned Value Management

Cost

Cost baseline

Actuals

Time
© 2012 pmwares – All rights reserved
Earned Value Management

Cost

Cost baseline

Actuals

Earned

Time
© 2012 pmwares – All rights reserved
Earned Value Management
AC
PV

Cost

Cost baseline

Actuals

Earned

EV

Time
© 2012 pmwares – All rights reserved

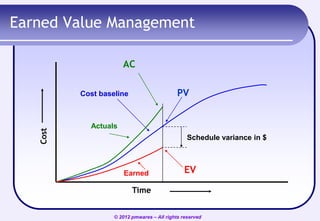

Earned Value Management
AC
PV

Cost

Cost baseline

Actuals
Schedule variance in $

Earned

EV

Time
© 2012 pmwares – All rights reserved

Earned Value Management
AC
PV

Cost

Cost baseline

Actuals
Cost variance

Earned

EV

Time
© 2012 pmwares – All rights reserved

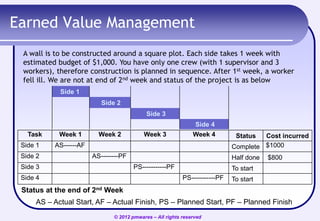

Earned Value Management
A wall is to be constructed around a square plot. Each side takes 1 week with
estimated budget of $1,000. You have only one crew (with 1 supervisor and 3
workers), therefore construction is planned in sequence. After 1st week, a worker
fell ill. We are not at end of 2nd week and status of the project is as below
Side 1
Side 2
Side 3
Side 4
Task
Side 1
Side 2

Week 1

Week 2

Week 3

Week 4

AS------AF
AS--------PF

Side 3

Cost incurred
Complete $1000
Half done

PS-----------PF

Side 4

Status

$800

To start
PS-----------PF

To start

Status at the end of 2nd Week
AS – Actual Start, AF – Actual Finish, PS – Planned Start, PF – Planned Finish
© 2012 pmwares – All rights reserved
Earned Value Management
#

Terms

1.

PV

2.

AC

3.

EV

4.

BAC

5.

CV

5.

SV

6.

CPI

7.

SPI

8.

EAC

9.

ETC

10.

VAC

Values

Comments

© 2012 pmwares – All rights reserved
Earned Value Management
#

Terms

1.
2.
3.
4.
5.
5.
6.

PV = 1000+1000
AC = 1000+800
EV = 1000+500
BAC
CV (EV-AC) = 1500 – 1800
SV (EV-PV) = 1500 – 2000
CPI (EV/AC) = 1500/1800

2000
1800
1500
4000
-300
-500
0.833

7.
8.

SPI (EV/PV) = 1500/2000
EAC (BAC/CPI) = 4000/0.833

0.75 We are progressing @ 75%
4801 We currently estimate that the total project
will cost $4801

9.

ETC (EAC–AC) = 4801 – 1800

3001 We currently estimate that we have to spend
$3001 to finish the project

10.

VAC (BAC–EAC) = 4000 – 4801

-801 We currently estimate that we will spend
$801 more than budgeted.

Values Comments
We planned to do work worth $2000
We actually spent $1800
We actually completed $1500 worth of work
Originally budgeted to complete in $4000
We are over budget by $300
We are behind schedule
We are getting 83 cents out of every dollar
invested

© 2012 pmwares – All rights reserved

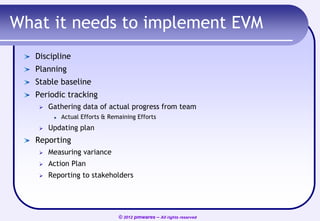

What it needs to implement EVM
Discipline
Planning
Stable baseline
Periodic tracking


Gathering data of actual progress from team
Actual Efforts & Remaining Efforts



Updating plan

Reporting


Measuring variance



Action Plan



Reporting to stakeholders

© 2012 pmwares – All rights reserved

Earned value management in action - A Webinar by Vivek Prakash, pmwares

  • 1.
    Earned Value Managementin Action Vivek Prakash – Aug, 16, 2012 © 2012 pmwares – All rights reserved
  • 2.
    Earned Value Management Definitions EVMTerms Explanation Planned Value (PV) Estimated value of the work planned to be spent as of today. Earned Value (EV) Value of the work that is completed as of today (PV of completed work) Actual Cost (AC) Total cost actually incurred as of today Budget at Completion (BAC) Total planned value of the project Estimate at Completion (EAC) Forecasted total project cost as of today Estimate to Complete (ETC) Estimated cost of the remaining work Variance at Completion (VAC) The variance of total project cost project as of today © 2012 pmwares – All rights reserved
  • 3.
    Earned Value Management Formulas EVMTerms EVM Formula Explanation Schedule Variance SV = EV - PV Measure of schedule performance. –ve value indicate delay Cost Variance CV = EV - AC Measure of cost performance. –ve value indicate cost overrun Schedule Performance Index SPI = EV/PV Measure of progress achieved. Value less than 1 indicate delay Cost Performance Index CPI = EV/AC Measure of value of the work completed. Value less than 1 indicate cost overun To Complete Performance Index TCPI = (BAC-EV) (BAC-AC) Measure of cost performance to be achieved on remaining work to meet project objectives Estimate to Complete ETC = EAC - AC Estimated cost of remaining work © 2012 pmwares – All rights reserved
  • 4.
    Earned Value Management Formulas EVMTerms EVM Formula Explanation Variance at Completion VAC = BAC - EAC Variance of total projected cost from budget AC + Bottom up ETC When original estimates are fundamentally flawed BAC Cumulative CPI Observing no variance, will continue with same expenditure rate AC + (BAC-EV) Variance observed as of now will not be observed in future. Will complete the project in remaining budget Estimate at Completion (EAC) AC + [(BAC-EV)/ Current variance trends will continue. (Cum.CPI x Cum.SPI)] Remaining budget is modified with cost and schedule performance © 2012 pmwares – All rights reserved
  • 5.
    Earned Value Management Cost Costbaseline Time © 2012 pmwares – All rights reserved
  • 6.
    Earned Value Management Cost Costbaseline Actuals Time © 2012 pmwares – All rights reserved
  • 7.
    Earned Value Management Cost Costbaseline Actuals Earned Time © 2012 pmwares – All rights reserved
  • 8.
    Earned Value Management AC PV Cost Costbaseline Actuals Earned EV Time © 2012 pmwares – All rights reserved
  • 9.
    Earned Value Management AC PV Cost Costbaseline Actuals Schedule variance in $ Earned EV Time © 2012 pmwares – All rights reserved
  • 10.
    Earned Value Management AC PV Cost Costbaseline Actuals Cost variance Earned EV Time © 2012 pmwares – All rights reserved
  • 11.
    Earned Value Management Awall is to be constructed around a square plot. Each side takes 1 week with estimated budget of $1,000. You have only one crew (with 1 supervisor and 3 workers), therefore construction is planned in sequence. After 1st week, a worker fell ill. We are not at end of 2nd week and status of the project is as below Side 1 Side 2 Side 3 Side 4 Task Side 1 Side 2 Week 1 Week 2 Week 3 Week 4 AS------AF AS--------PF Side 3 Cost incurred Complete $1000 Half done PS-----------PF Side 4 Status $800 To start PS-----------PF To start Status at the end of 2nd Week AS – Actual Start, AF – Actual Finish, PS – Planned Start, PF – Planned Finish © 2012 pmwares – All rights reserved
  • 12.

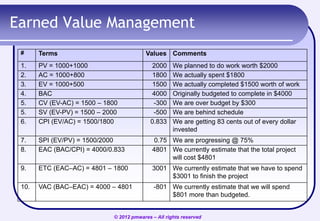

  • 13.
