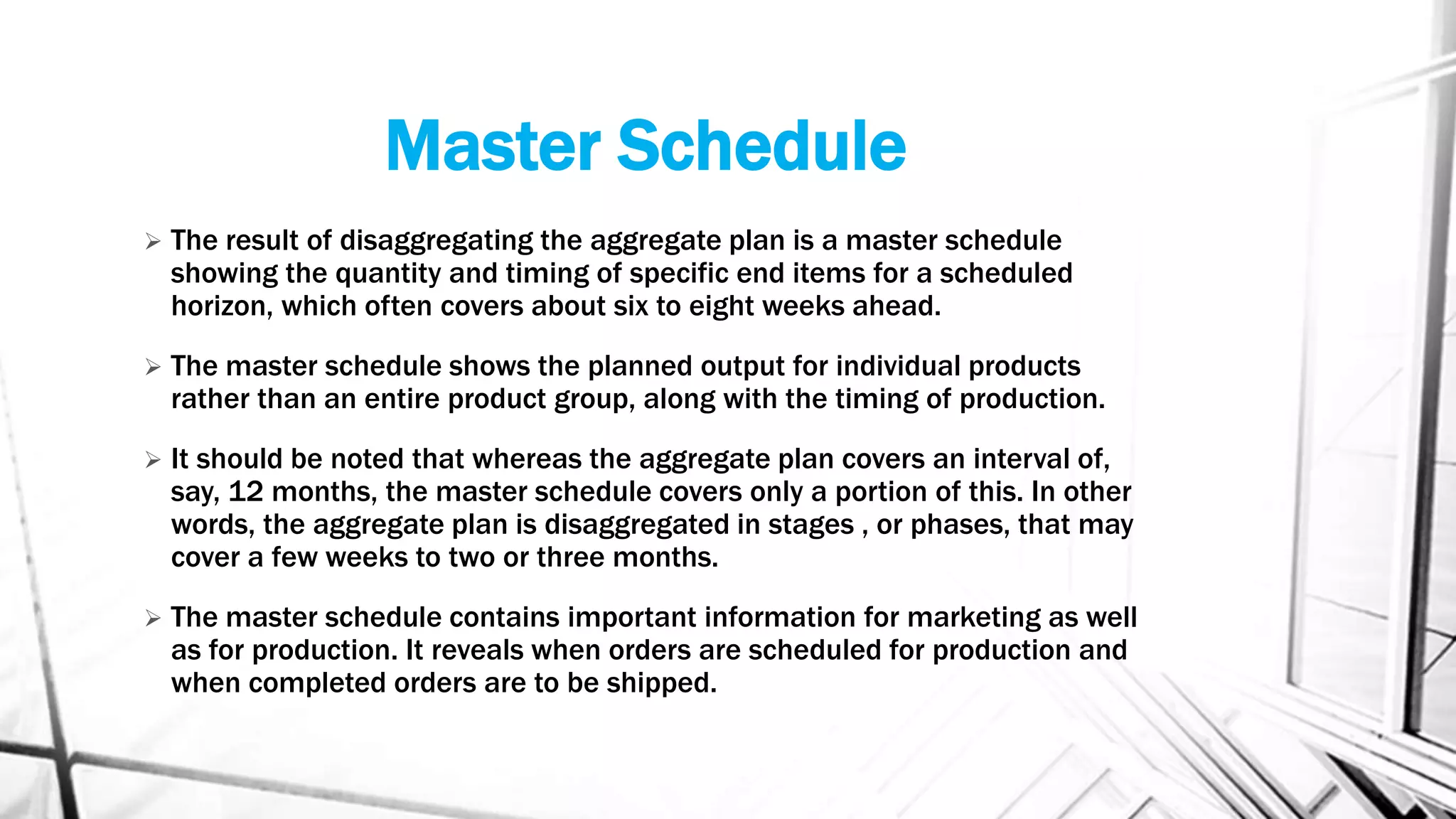

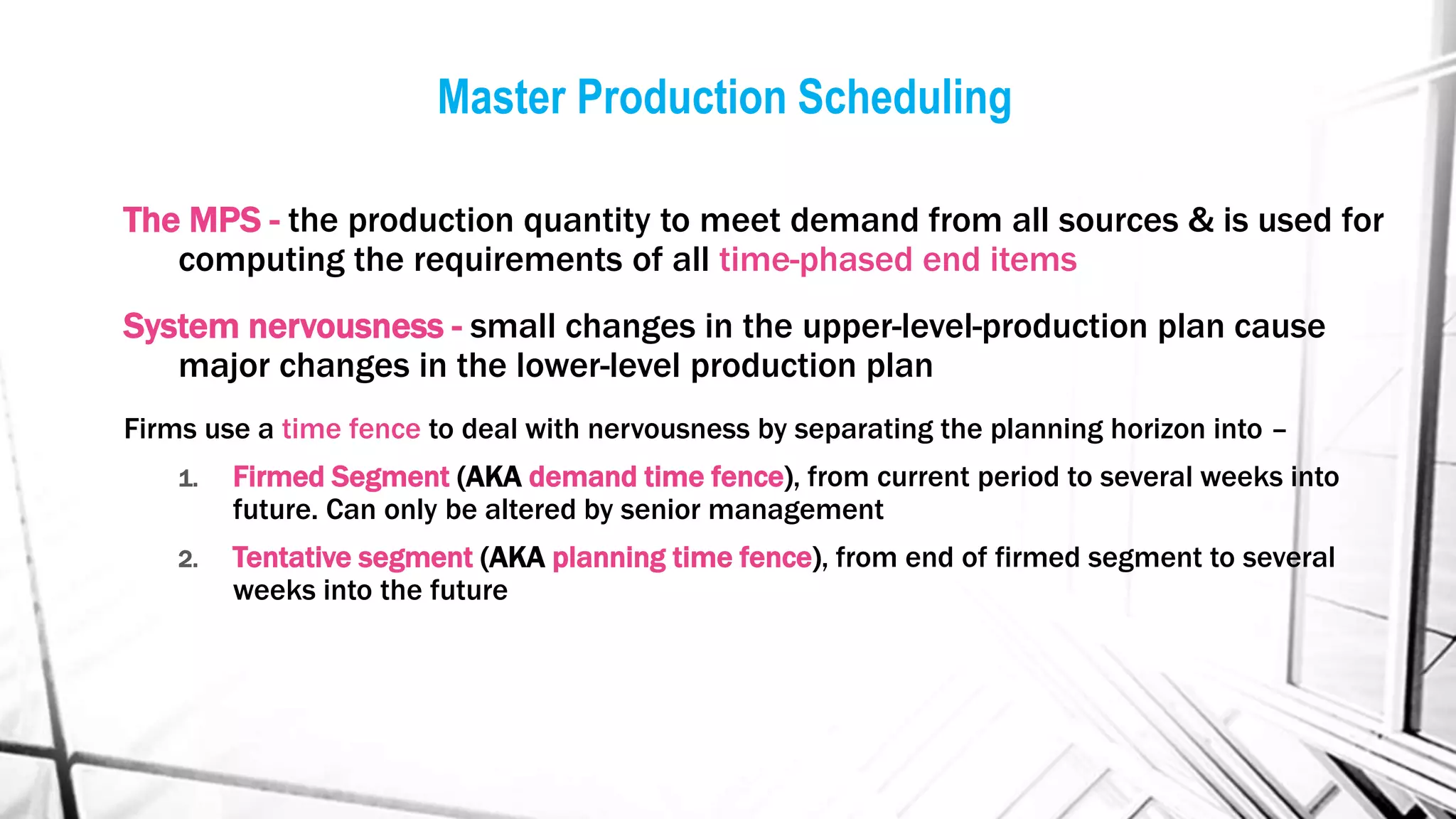

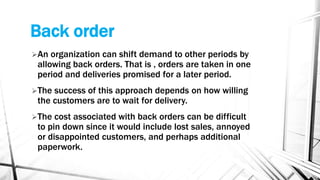

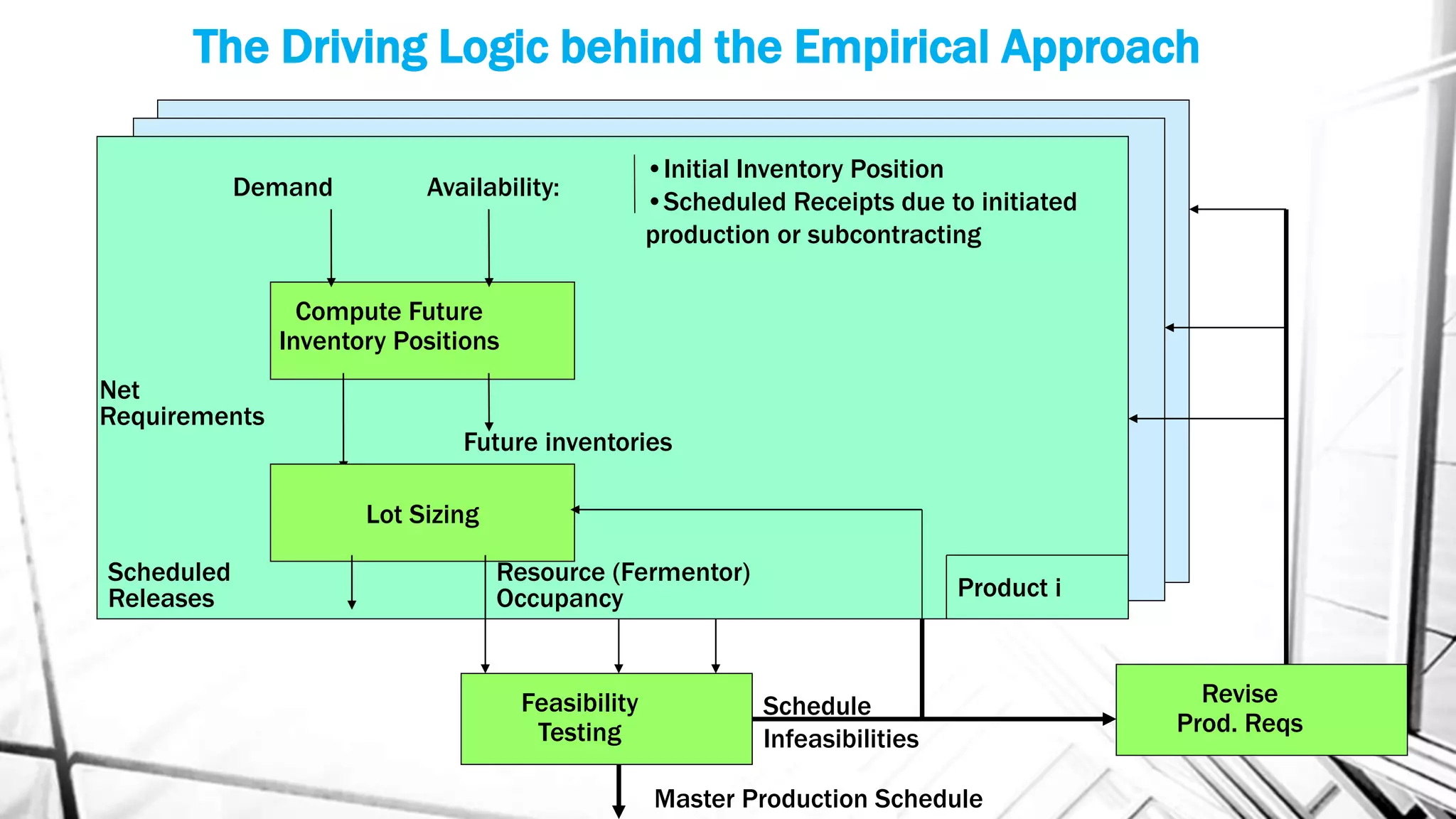

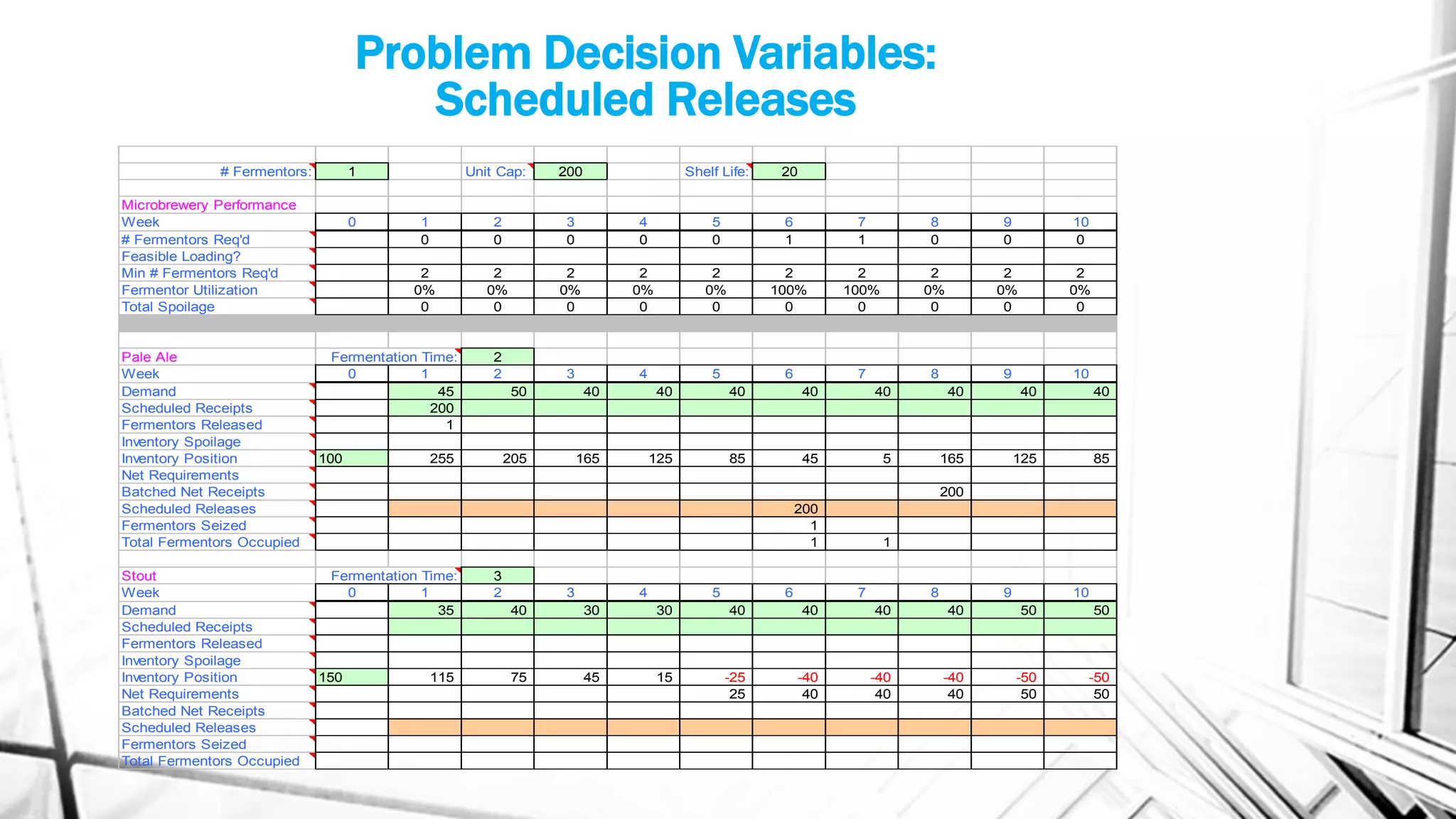

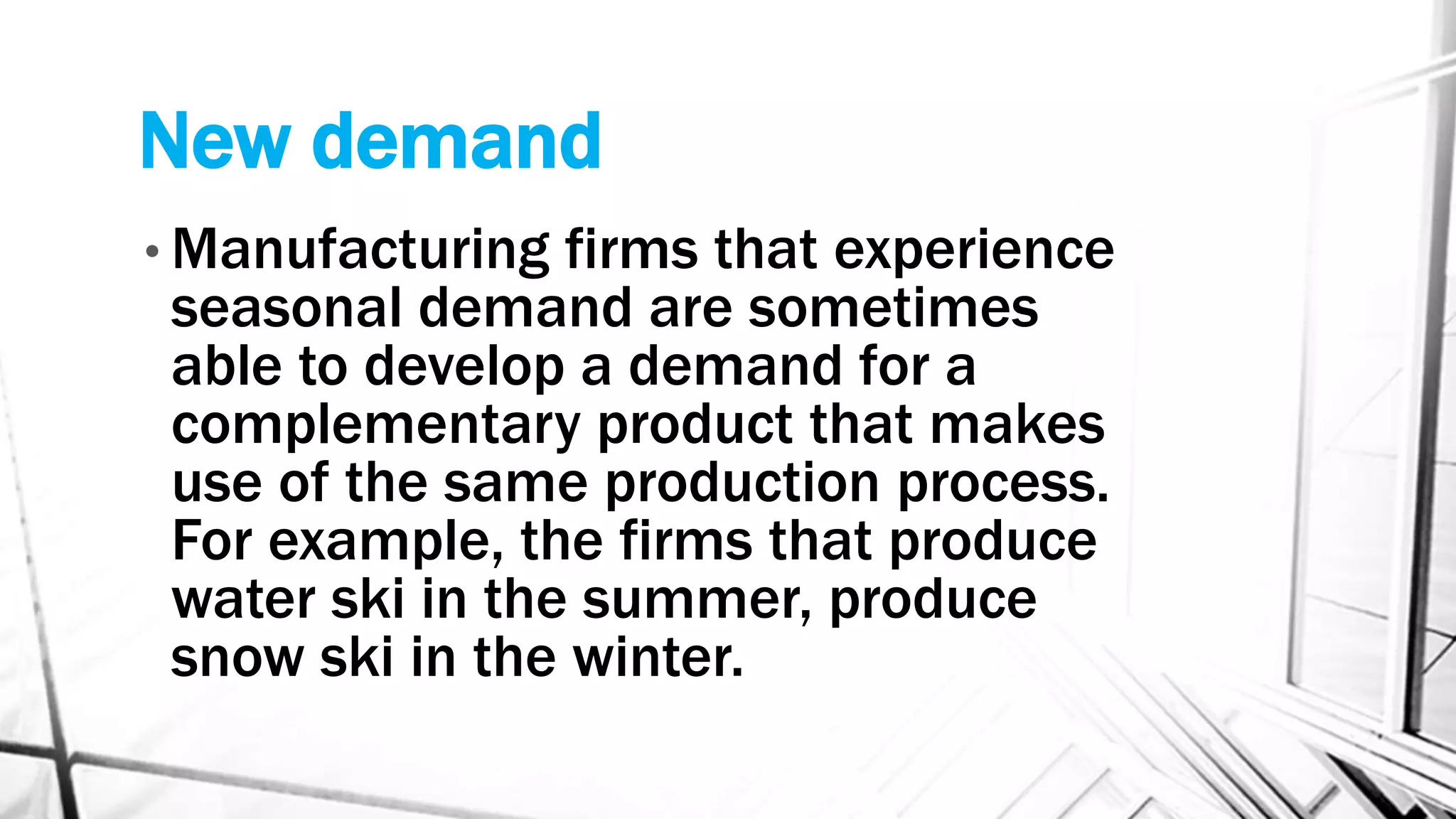

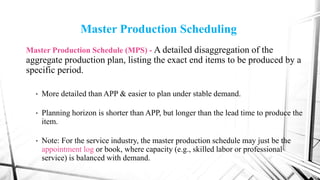

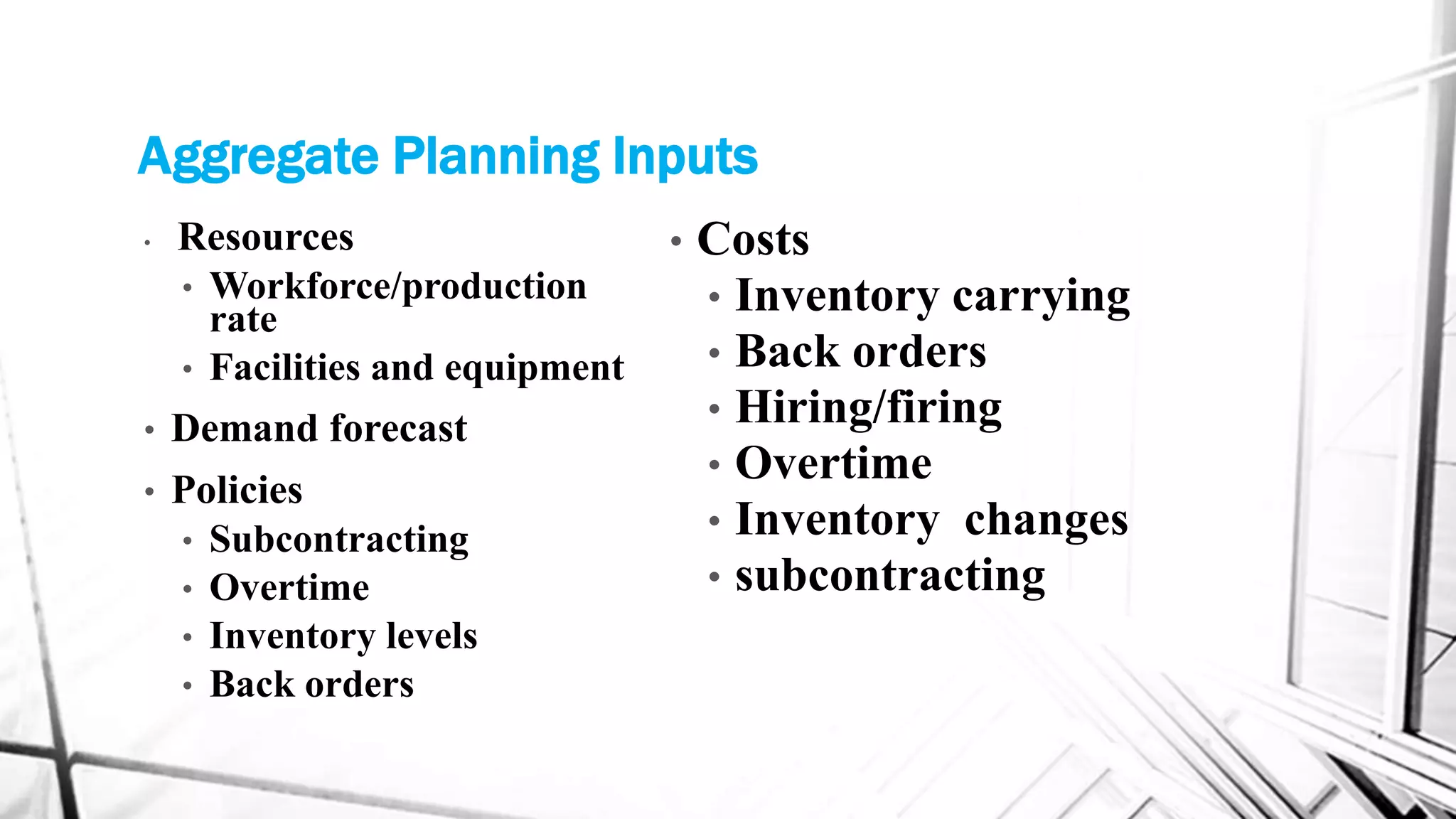

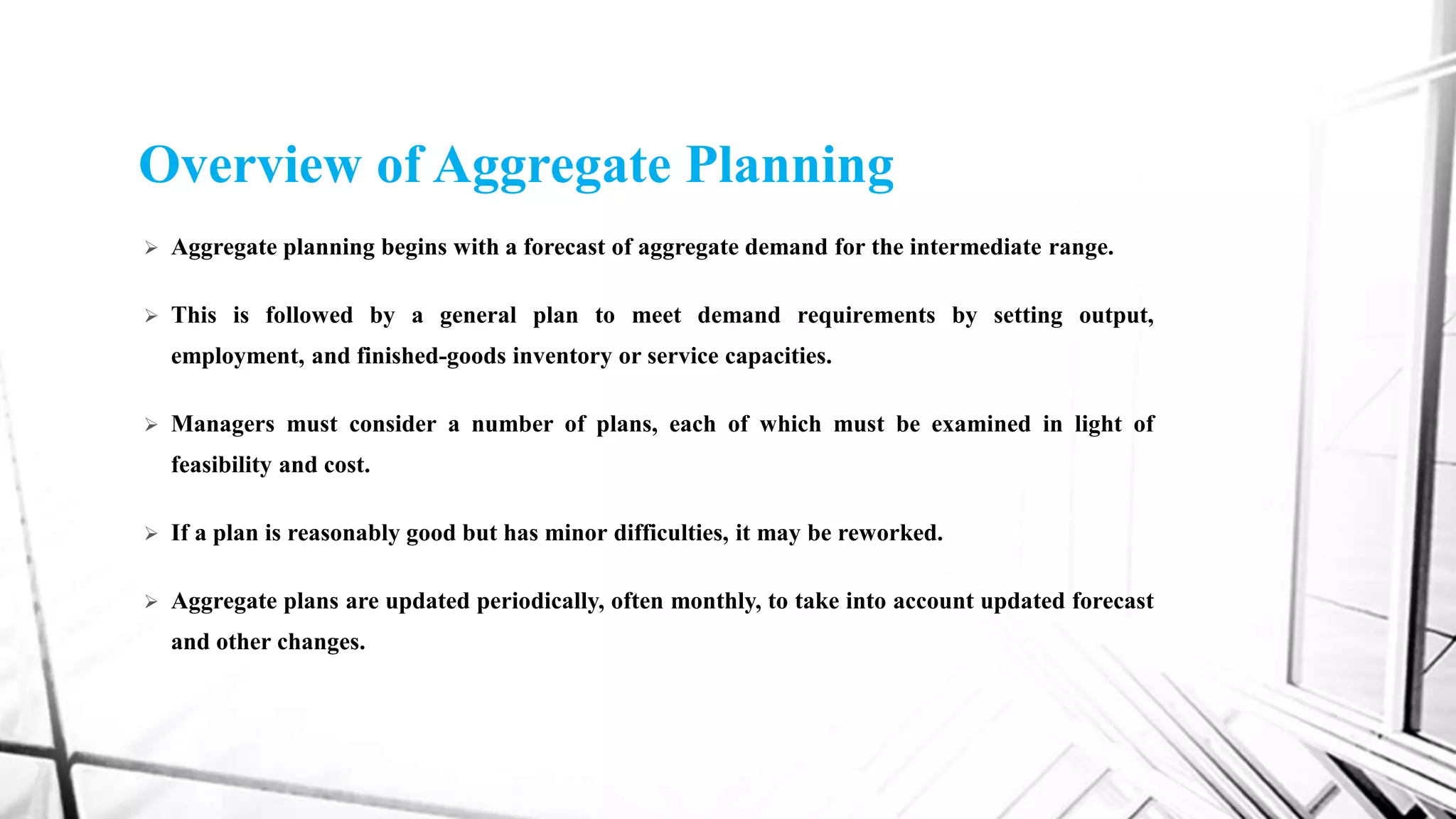

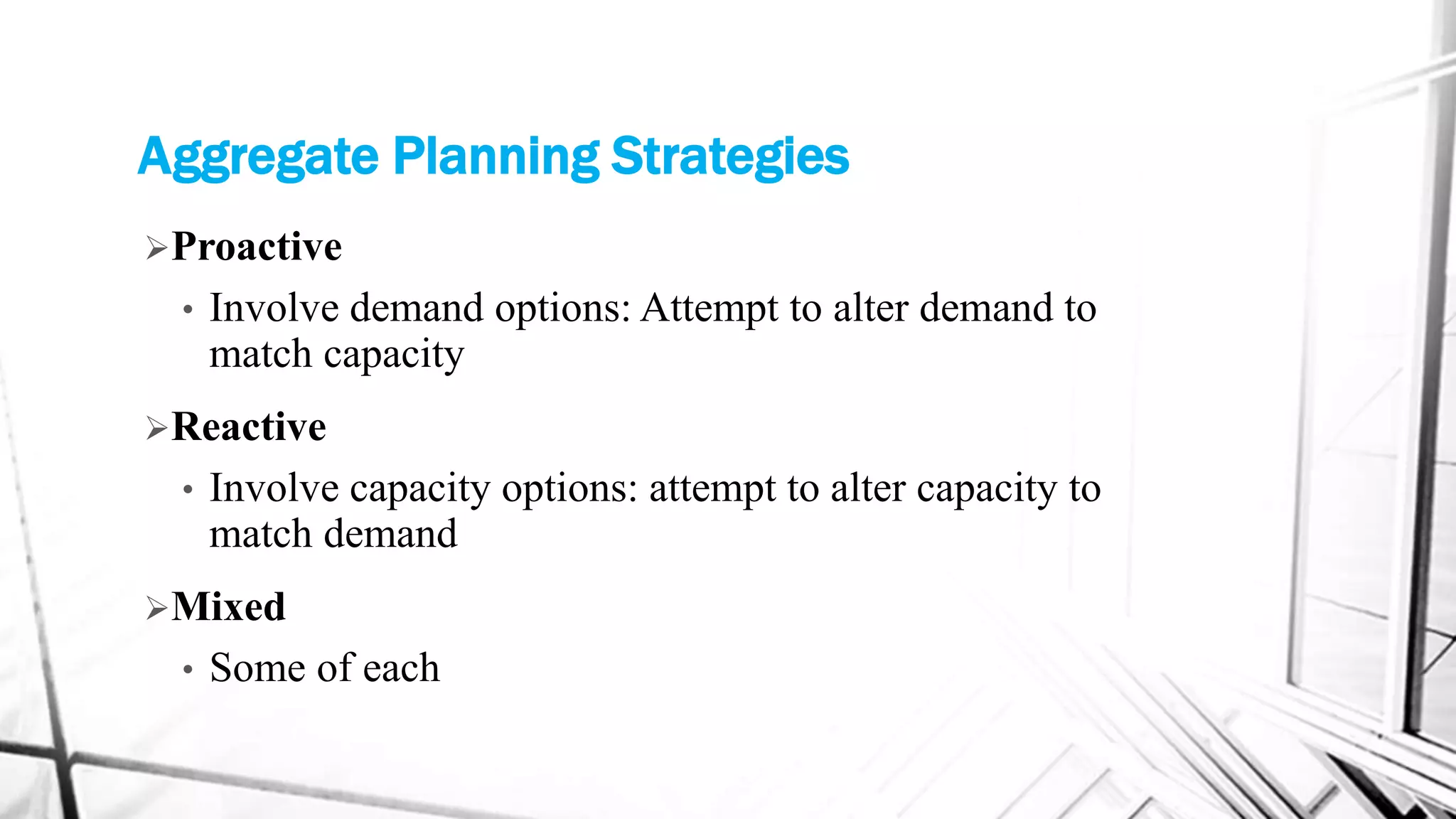

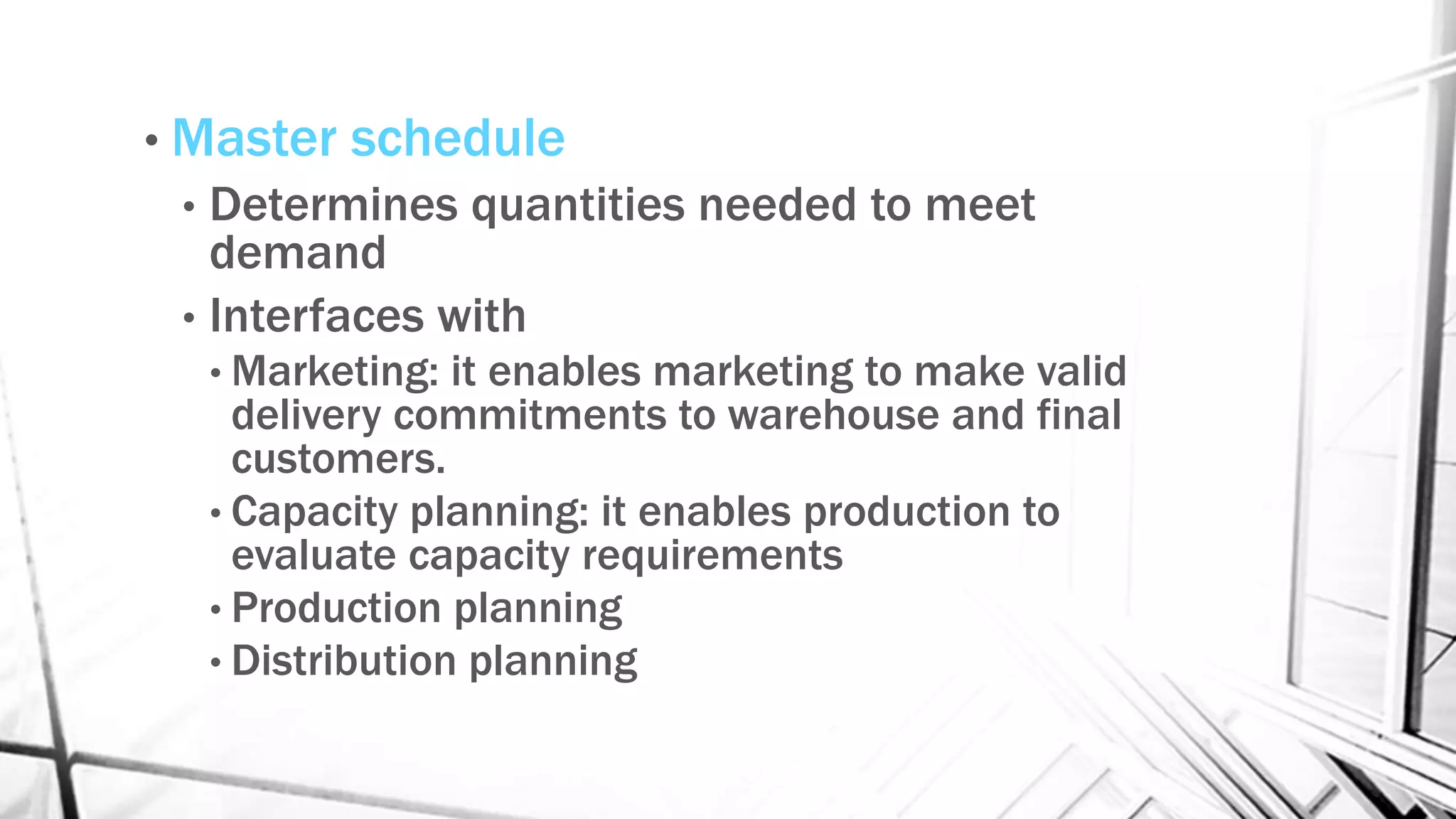

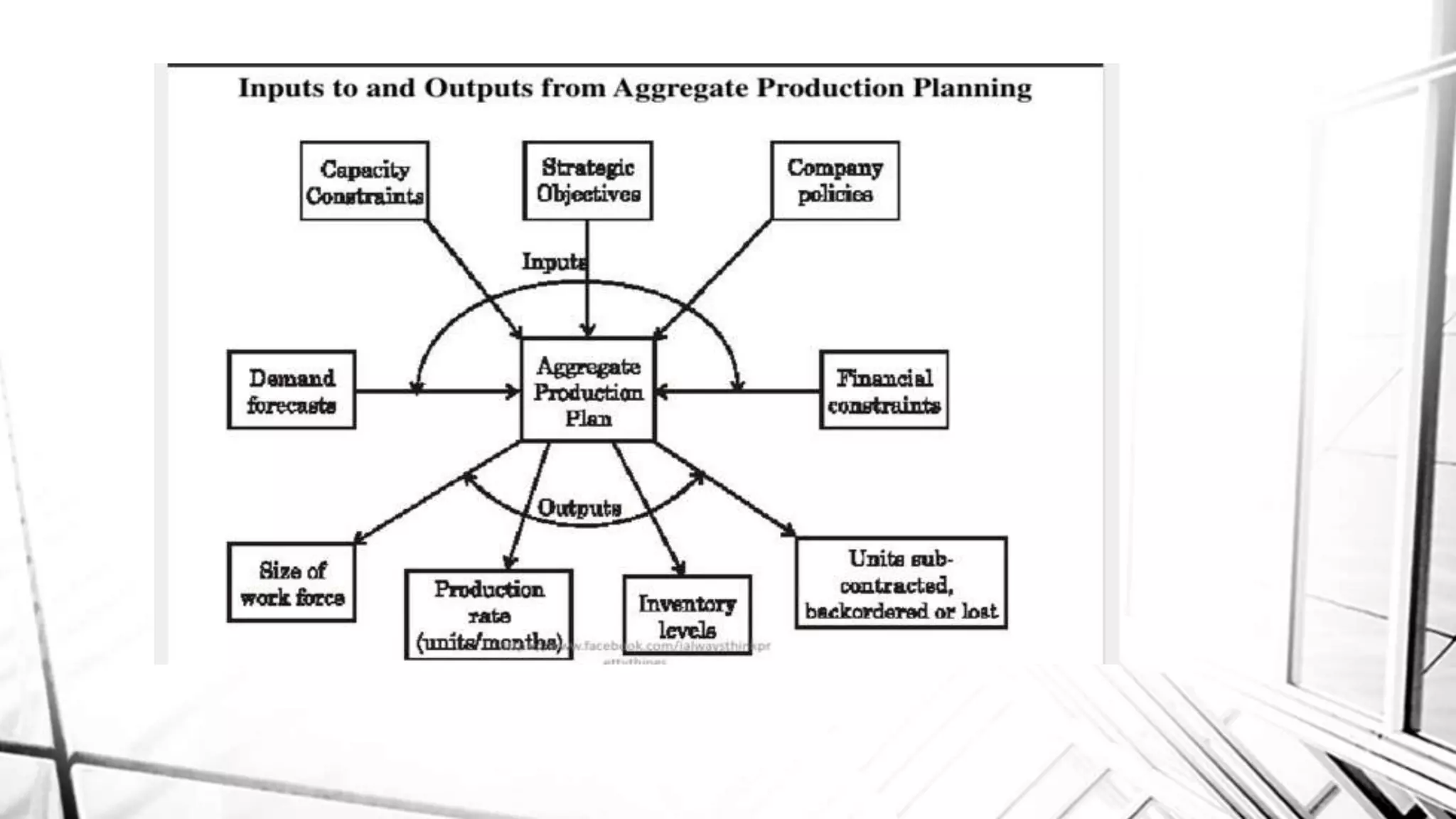

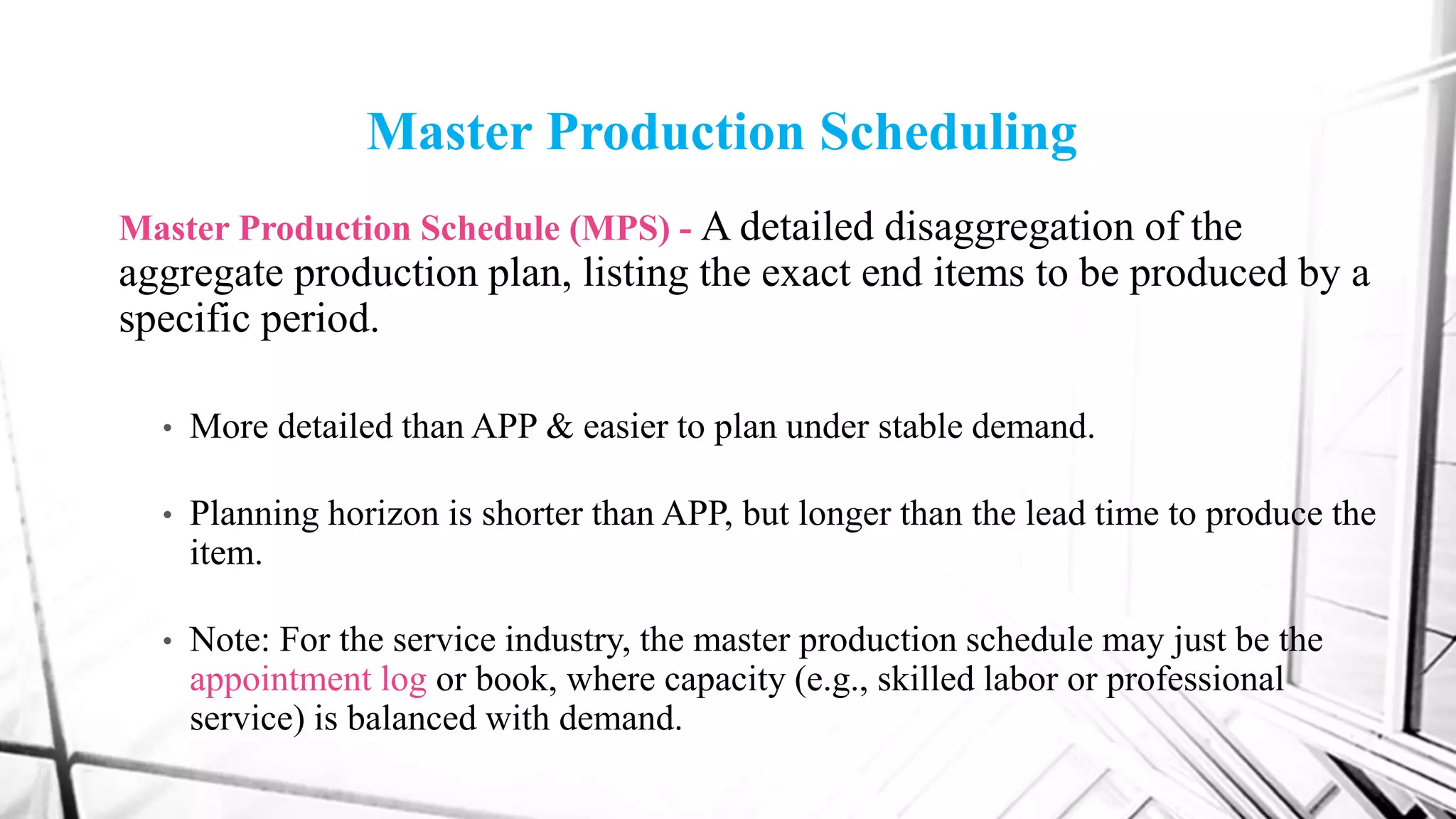

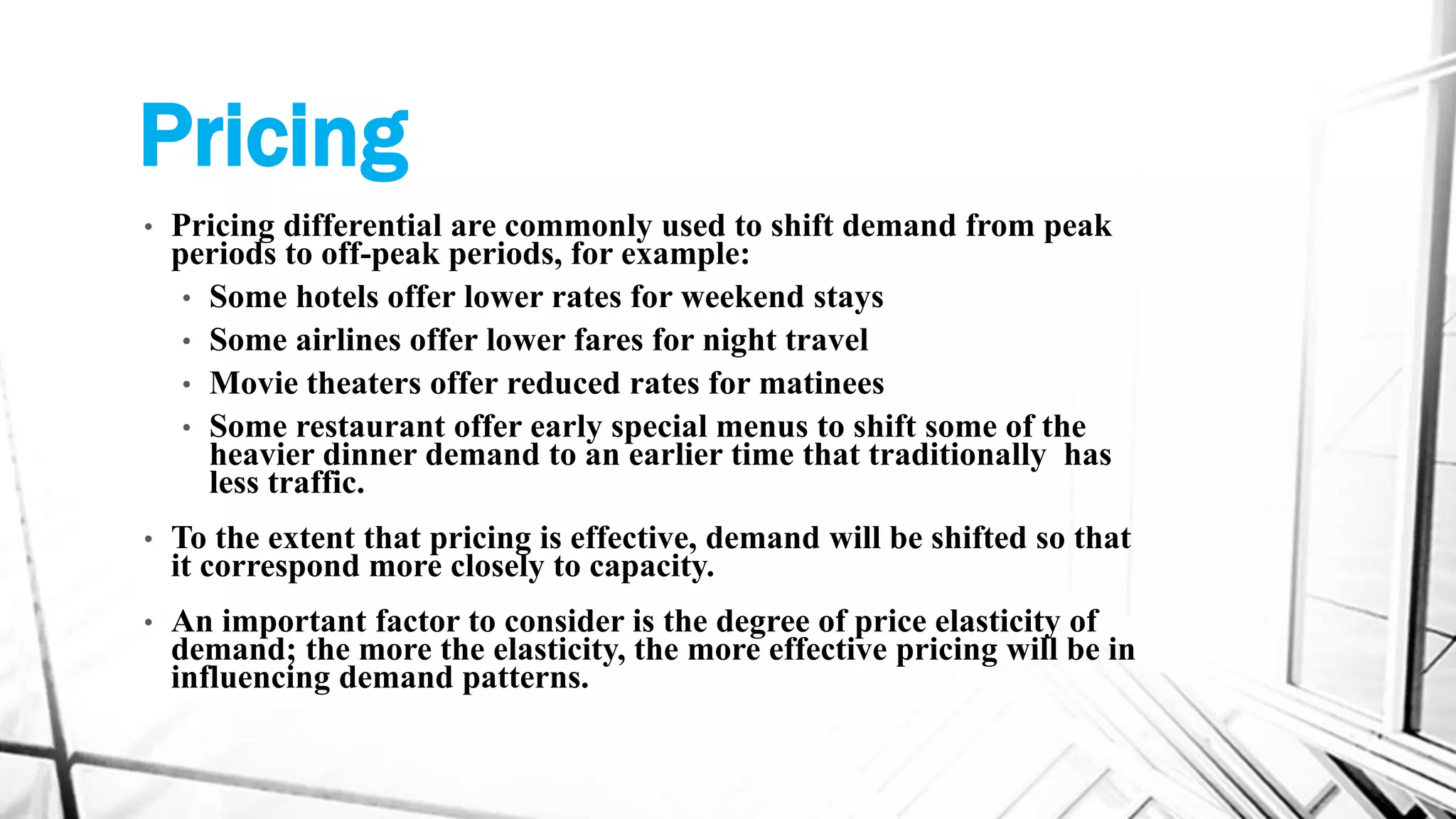

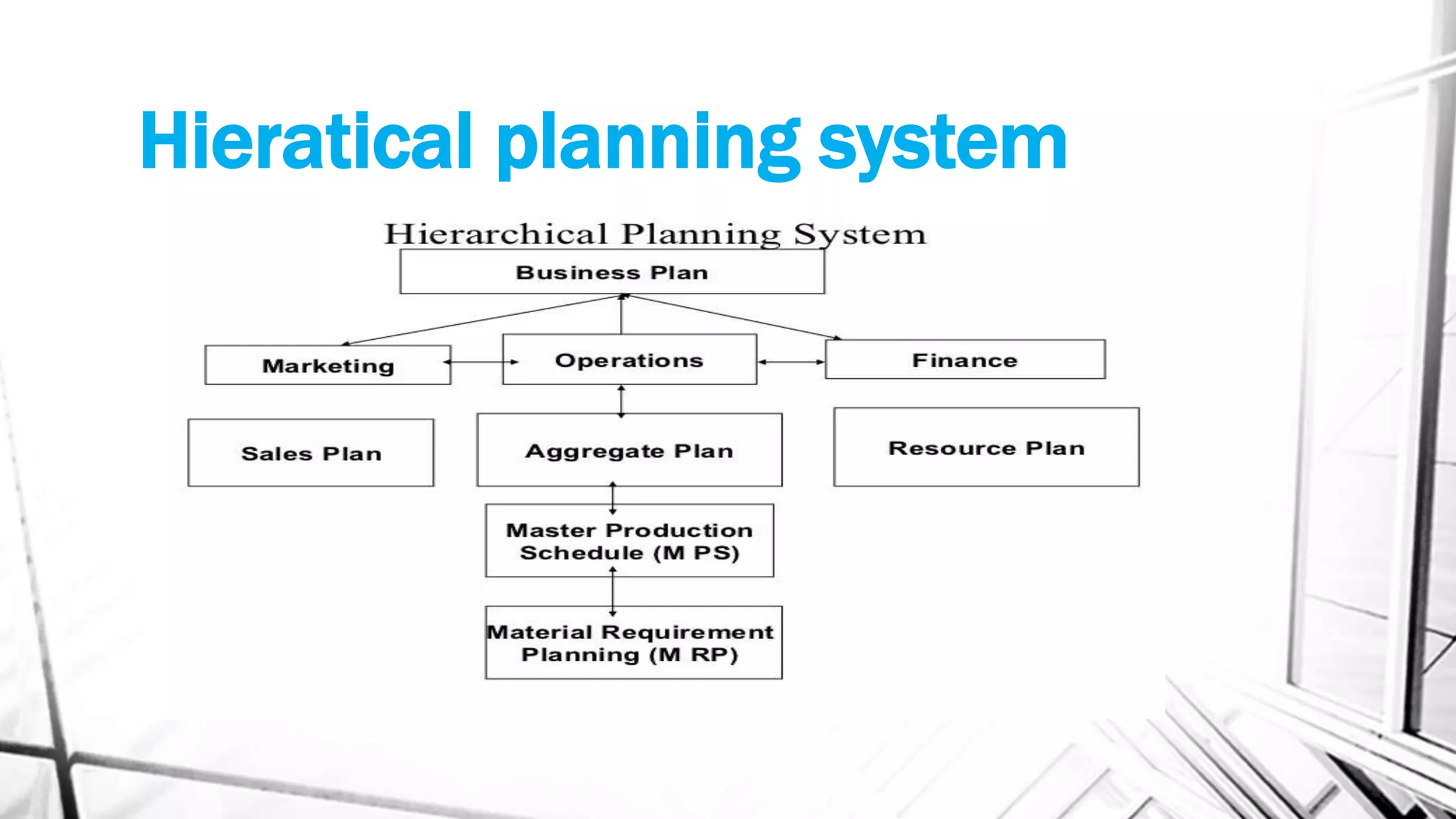

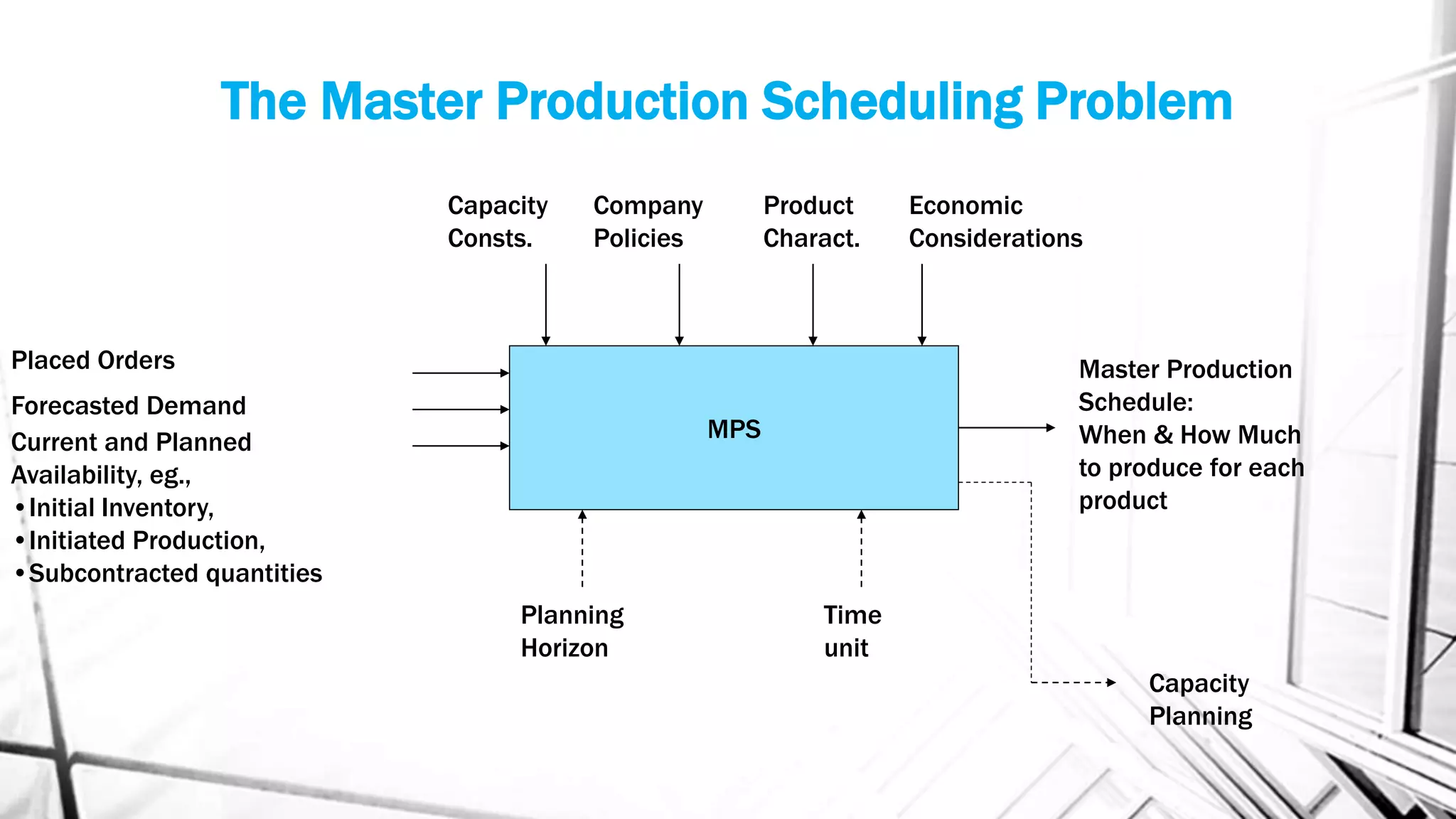

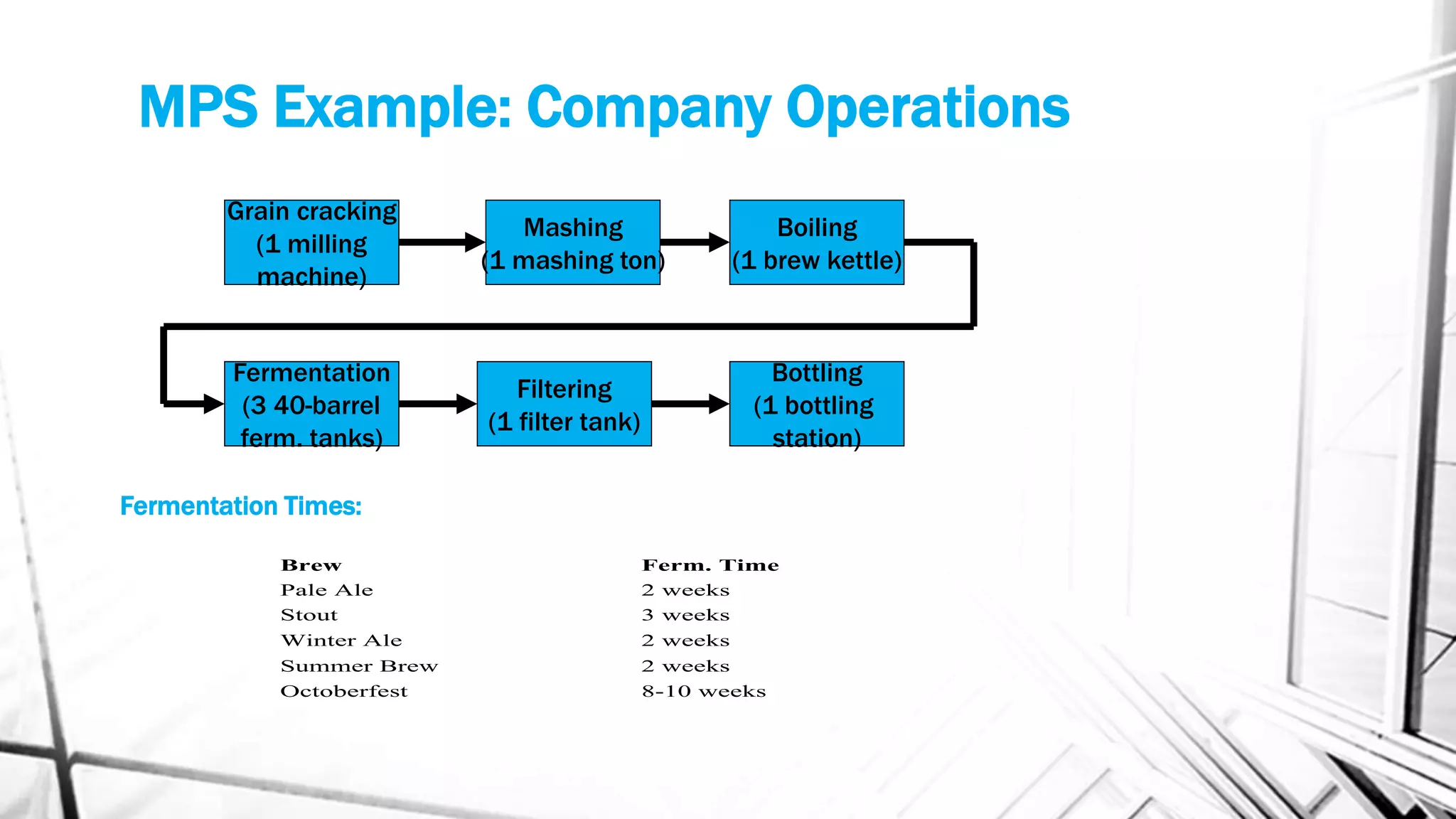

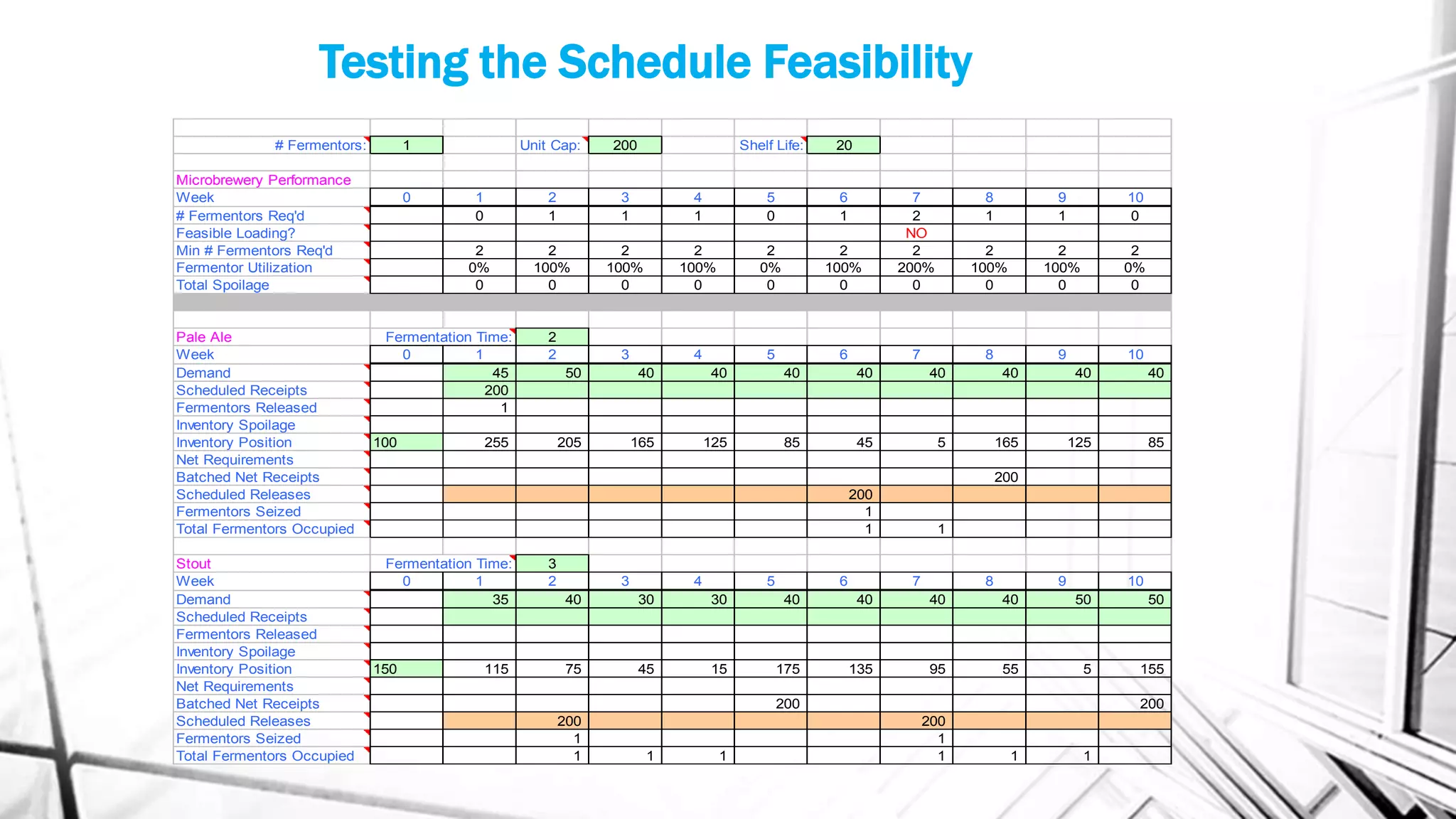

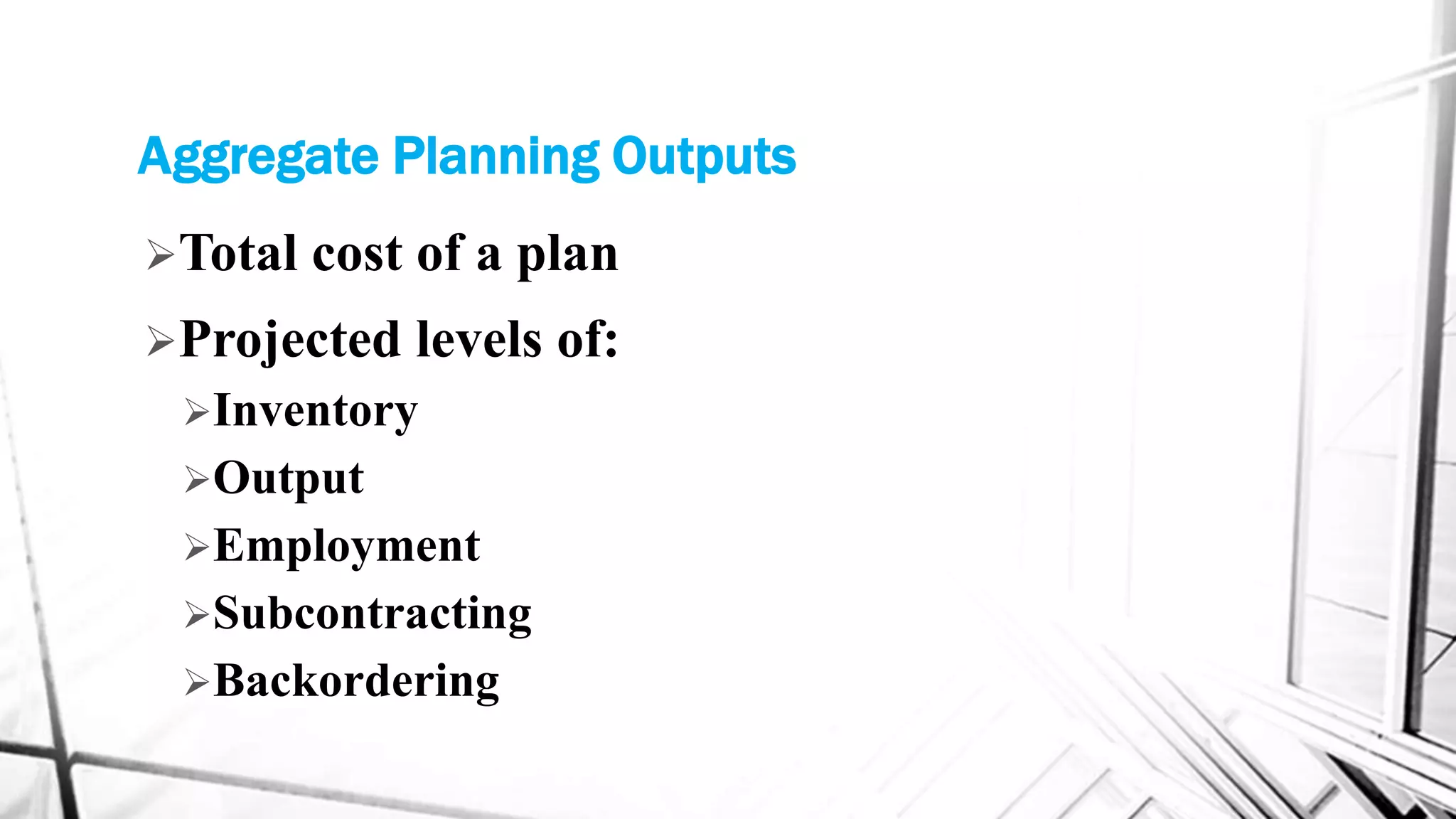

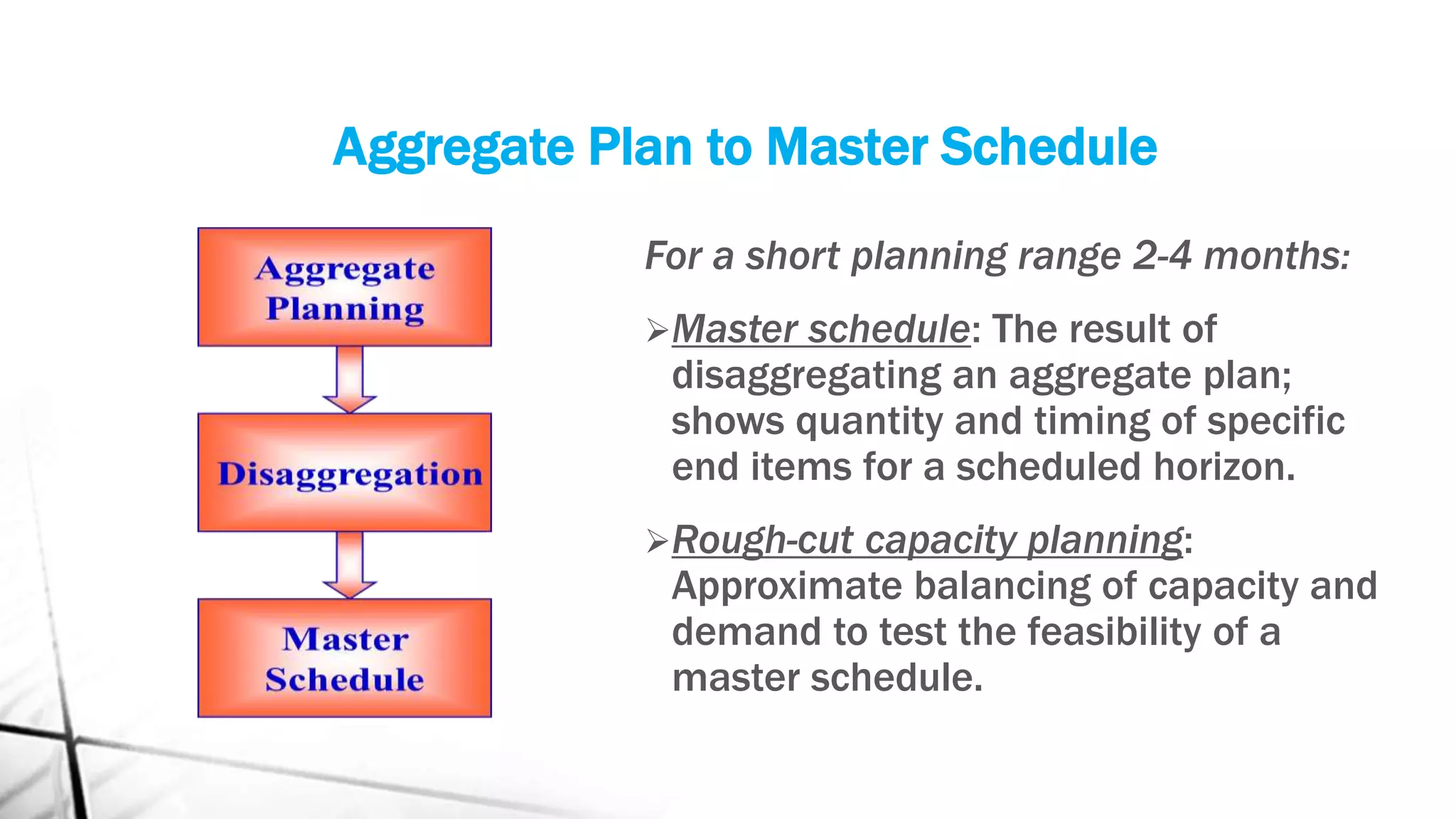

The document discusses aggregate planning and master production scheduling. It provides an overview of aggregate planning, including forecasting demand and setting output levels to meet demand. It also discusses developing a master production schedule by disaggregating the aggregate plan into specific end items and timing of production. The master schedule covers a shorter horizon than the aggregate plan, typically 6-8 weeks. It aims to balance demand with capacity and production resources.
