Profesor:
Asignatura:
Departamento:
Mastes Scheduling
Producción I
IITI
MC. Ma. del Pilar C. León Franco
Master Scheduling (MPS)
• It forms the link between production
planning and what manufacturing will
actually build.
• It forms the basis for calculating the
capacity and resources needed
• The MPS drives the material
requirements plan
• It keeps priorities valid. The MPS is a
priority plan for manufacturing.
Master Scheduling (MPS)
• The end items made by the company
are assembled from component and
subcomponents parts. These must be
available in the right quantities at the
right time to support the master
production schedule. The material
requirements planning system plan the
schedule for these components based
on the needs of the MPS.

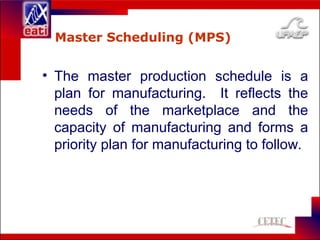

Master Scheduling (MPS)
• The master production schedule is a
plan for manufacturing. It reflects the
needs of the marketplace and the
capacity of manufacturing and forms a
priority plan for manufacturing to follow.

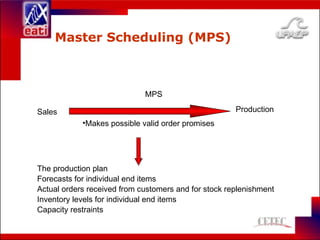

Master Scheduling (MPS)
MPS
•Makes possible valid order promises
Sales Production
The production plan
Forecasts for individual end items
Actual orders received from customers and for stock replenishment
Inventory levels for individual end items
Capacity restraints
Relationship to produce plan
Week
1 2 3 4 5 6
Aggregate Forecast
(units) 160 160 160 160 215 250
Production Plan
Aggregate
Inventory (units) 500
Developing a Master production
Schedule
• The objectives in developing an MPS are:
• To maintain the desired level of customer
service by maintaining finished-goods
inventory levels or by schedule to meet
customer delivery requirements
• To make the best use of material, labor and
equipment
• To maintain inventory investment at the
required levels

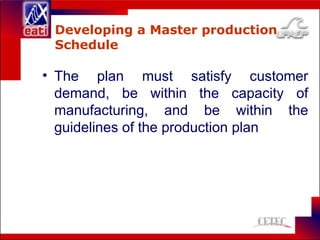

Developing a Master production
Schedule
• The plan must satisfy customer
demand, be within the capacity of
manufacturing, and be within the
guidelines of the production plan
Developing a Master production
Schedule
• Steps:
– Develop a preliminary MPS
– Check the preliminary MPS against
available capacity
– Resolve differences between the
preliminary MPS and capacity availability
Preliminary Master Production
Schedule
Week 0 1 2 3 4 5 6
Forecast 60 60 60 60 60 60
Projected Available 80 20 60 0 40 80 20
MPS 100 100 100
Rough-Cut Capacity Planning
• RCCP checks whether critical resources
are available to support the preliminary
master production schedules. Critical
resources include bottleneck
operations, labor, and critical materials.
Rough-Cut Capacity Planning
Week 0 1 2 3 Total
Medium 40 25 40 15 120
Fine 20 10 30 20 80
Medium 0.5 hrs./unit
Fine 1.2 hrs./unit
Week 0 1 2 3 Total
Medium
Fine
Total Horas

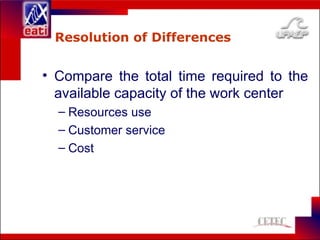

Resolution of Differences
• Compare the total time required to the
available capacity of the work center
– Resources use
– Customer service
– Cost
Master Schedule Decisions
• The MPS should represent as efficiently as
possible what manufacturing will make.
• Make to stock products: Limited number of
standard items are assembled from many
components
• Make to order products: Many different
ended items are made form a small number
of components
• Assemble to order products: Many end
items can be made form combinations of
basic components and subassemblies.

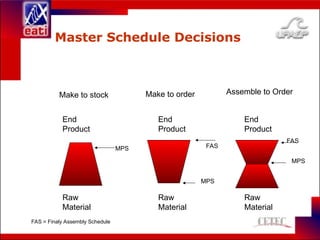

Master Schedule Decisions
Make to stock Assemble to Order
Make to order
End
Product
Raw
Material
End
Product
Raw
Material
End
Product
Raw
Material
MPS
MPS
MPS
FAS
FAS
FAS = Finaly Assembly Schedule

Master Production scheduling Plan in Production

  • 1.
  • 2.
    Master Scheduling (MPS) •It forms the link between production planning and what manufacturing will actually build. • It forms the basis for calculating the capacity and resources needed • The MPS drives the material requirements plan • It keeps priorities valid. The MPS is a priority plan for manufacturing.
  • 3.
    Master Scheduling (MPS) •The end items made by the company are assembled from component and subcomponents parts. These must be available in the right quantities at the right time to support the master production schedule. The material requirements planning system plan the schedule for these components based on the needs of the MPS.
  • 4.
    Master Scheduling (MPS) •The master production schedule is a plan for manufacturing. It reflects the needs of the marketplace and the capacity of manufacturing and forms a priority plan for manufacturing to follow.
  • 5.
    Master Scheduling (MPS) MPS •Makespossible valid order promises Sales Production The production plan Forecasts for individual end items Actual orders received from customers and for stock replenishment Inventory levels for individual end items Capacity restraints
  • 6.
    Relationship to produceplan Week 1 2 3 4 5 6 Aggregate Forecast (units) 160 160 160 160 215 250 Production Plan Aggregate Inventory (units) 500
  • 7.
    Developing a Masterproduction Schedule • The objectives in developing an MPS are: • To maintain the desired level of customer service by maintaining finished-goods inventory levels or by schedule to meet customer delivery requirements • To make the best use of material, labor and equipment • To maintain inventory investment at the required levels
  • 8.
    Developing a Masterproduction Schedule • The plan must satisfy customer demand, be within the capacity of manufacturing, and be within the guidelines of the production plan
  • 9.
    Developing a Masterproduction Schedule • Steps: – Develop a preliminary MPS – Check the preliminary MPS against available capacity – Resolve differences between the preliminary MPS and capacity availability
  • 10.
    Preliminary Master Production Schedule Week0 1 2 3 4 5 6 Forecast 60 60 60 60 60 60 Projected Available 80 20 60 0 40 80 20 MPS 100 100 100
  • 11.
    Rough-Cut Capacity Planning •RCCP checks whether critical resources are available to support the preliminary master production schedules. Critical resources include bottleneck operations, labor, and critical materials.
  • 12.
    Rough-Cut Capacity Planning Week0 1 2 3 Total Medium 40 25 40 15 120 Fine 20 10 30 20 80 Medium 0.5 hrs./unit Fine 1.2 hrs./unit Week 0 1 2 3 Total Medium Fine Total Horas
  • 13.
    Resolution of Differences •Compare the total time required to the available capacity of the work center – Resources use – Customer service – Cost
  • 14.
    Master Schedule Decisions •The MPS should represent as efficiently as possible what manufacturing will make. • Make to stock products: Limited number of standard items are assembled from many components • Make to order products: Many different ended items are made form a small number of components • Assemble to order products: Many end items can be made form combinations of basic components and subassemblies.
  • 15.
    Master Schedule Decisions Maketo stock Assemble to Order Make to order End Product Raw Material End Product Raw Material End Product Raw Material MPS MPS MPS FAS FAS FAS = Finaly Assembly Schedule
