The document discusses various project scheduling techniques including network diagrams, critical path method, critical chain method, Gantt charts, and PERT charts. It provides examples of how to create activity network diagrams using the activity-on-node and activity-on-arrow methods. The critical path method is described as identifying the longest path of dependent tasks in a project network diagram. However, issues with this method include assuming unlimited resources and misuse of float. The critical chain method is presented as modifying the critical path method to consider limited resource availability by using buffers instead of float.

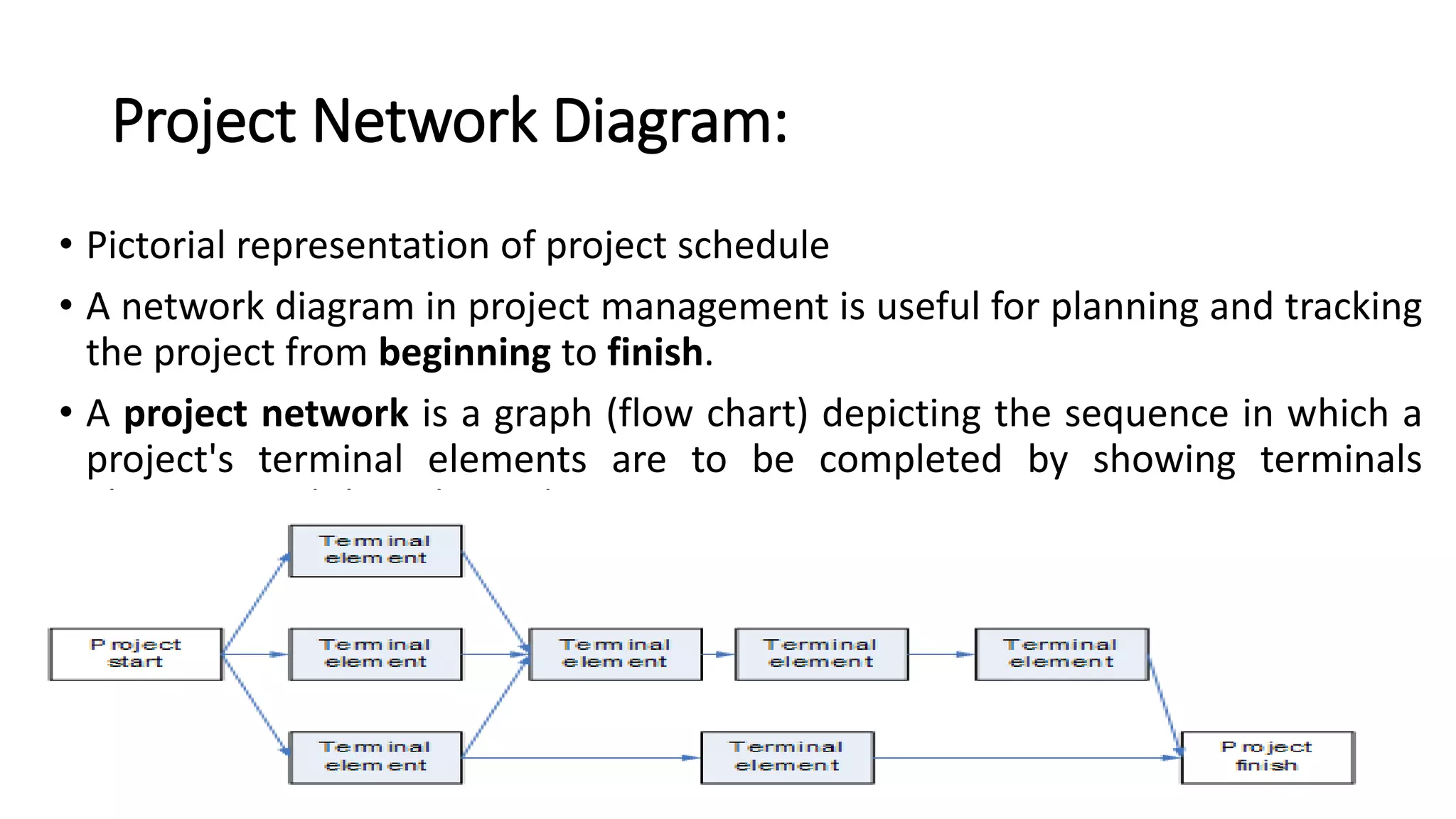

Project Network Diagram:
•Pictorial representation of project schedule
• A network diagram in project management is useful for planning and tracking
the project from beginning to finish.
• A project network is a graph (flow chart) depicting the sequence in which a
project's terminal elements are to be completed by showing terminals
elements and their dependencies.
• It is always drawn from left to right to reflect project chronology.
3.

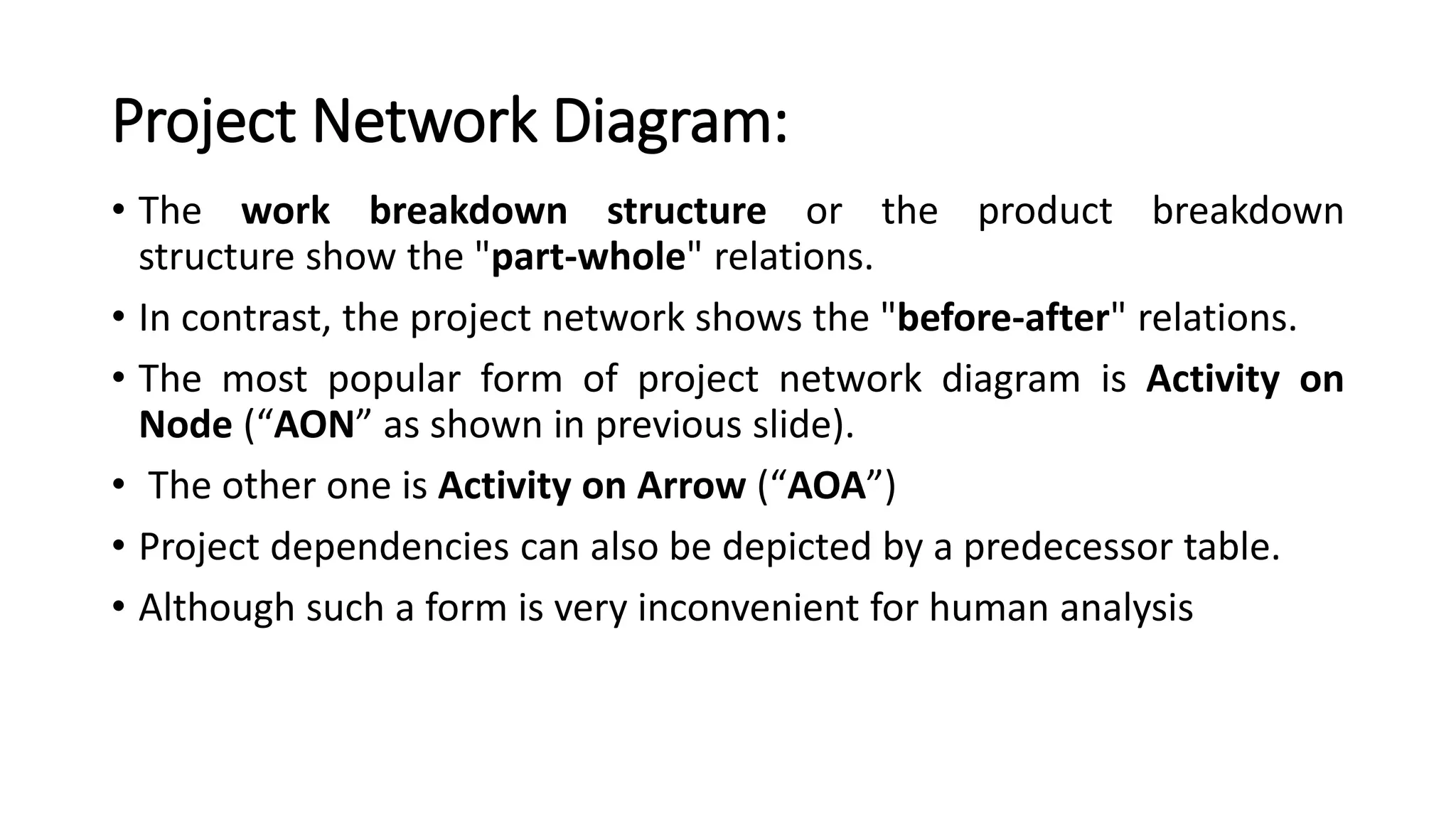

Project Network Diagram:
•The work breakdown structure or the product breakdown
structure show the "part-whole" relations.
• In contrast, the project network shows the "before-after" relations.
• The most popular form of project network diagram is Activity on
Node (“AON” as shown in previous slide).
• The other one is Activity on Arrow (“AOA”)
• Project dependencies can also be depicted by a predecessor table.
• Although such a form is very inconvenient for human analysis
5.
Activity on NodeExample:

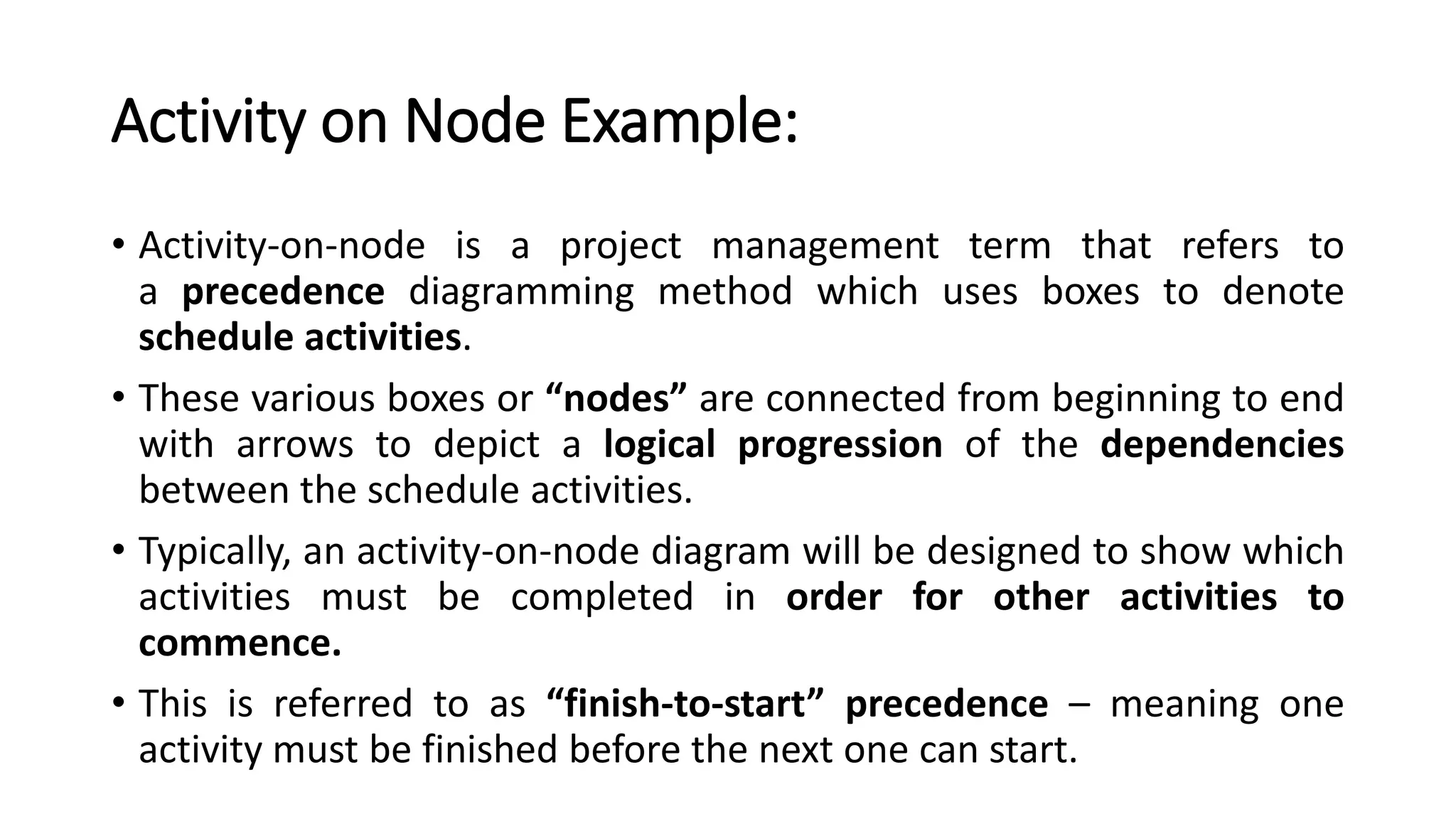

• Activity-on-node is a project management term that refers to
a precedence diagramming method which uses boxes to denote
schedule activities.
• These various boxes or “nodes” are connected from beginning to end
with arrows to depict a logical progression of the dependencies
between the schedule activities.
• Typically, an activity-on-node diagram will be designed to show which
activities must be completed in order for other activities to
commence.
• This is referred to as “finish-to-start” precedence – meaning one
activity must be finished before the next one can start.
6.

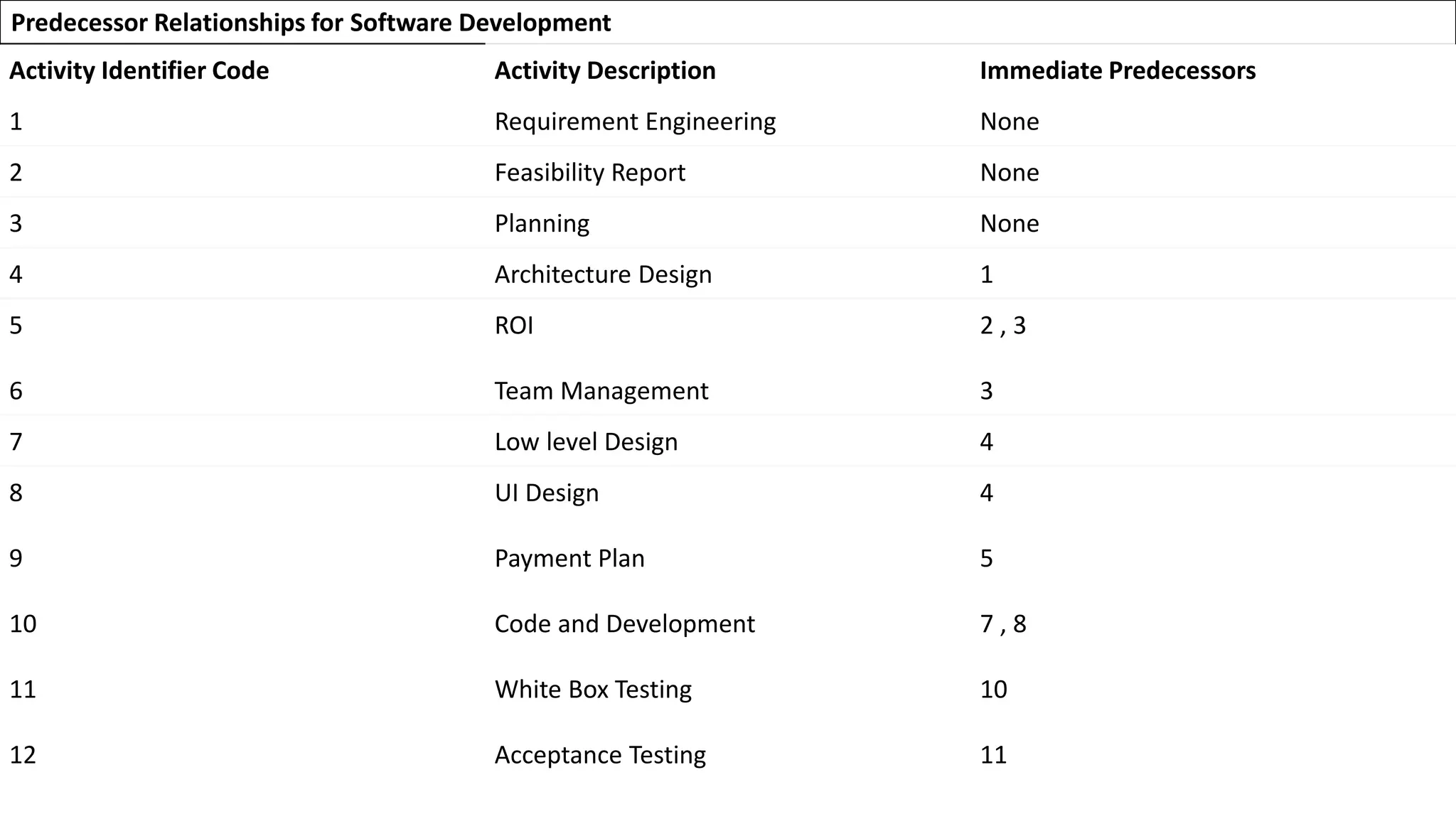

Predecessor Relationships forSoftware Development
Activity Identifier Code Activity Description Immediate Predecessors
1 Requirement Engineering None
2 Feasibility Report None
3 Planning None
4 Architecture Design 1
5
6
ROI
Team Management
2 , 3
3
7 Low level Design 4
8
9
10
11
12
UI Design
Payment Plan
Code and Development
White Box Testing
Acceptance Testing
4
5
7 , 8
10
11
7.

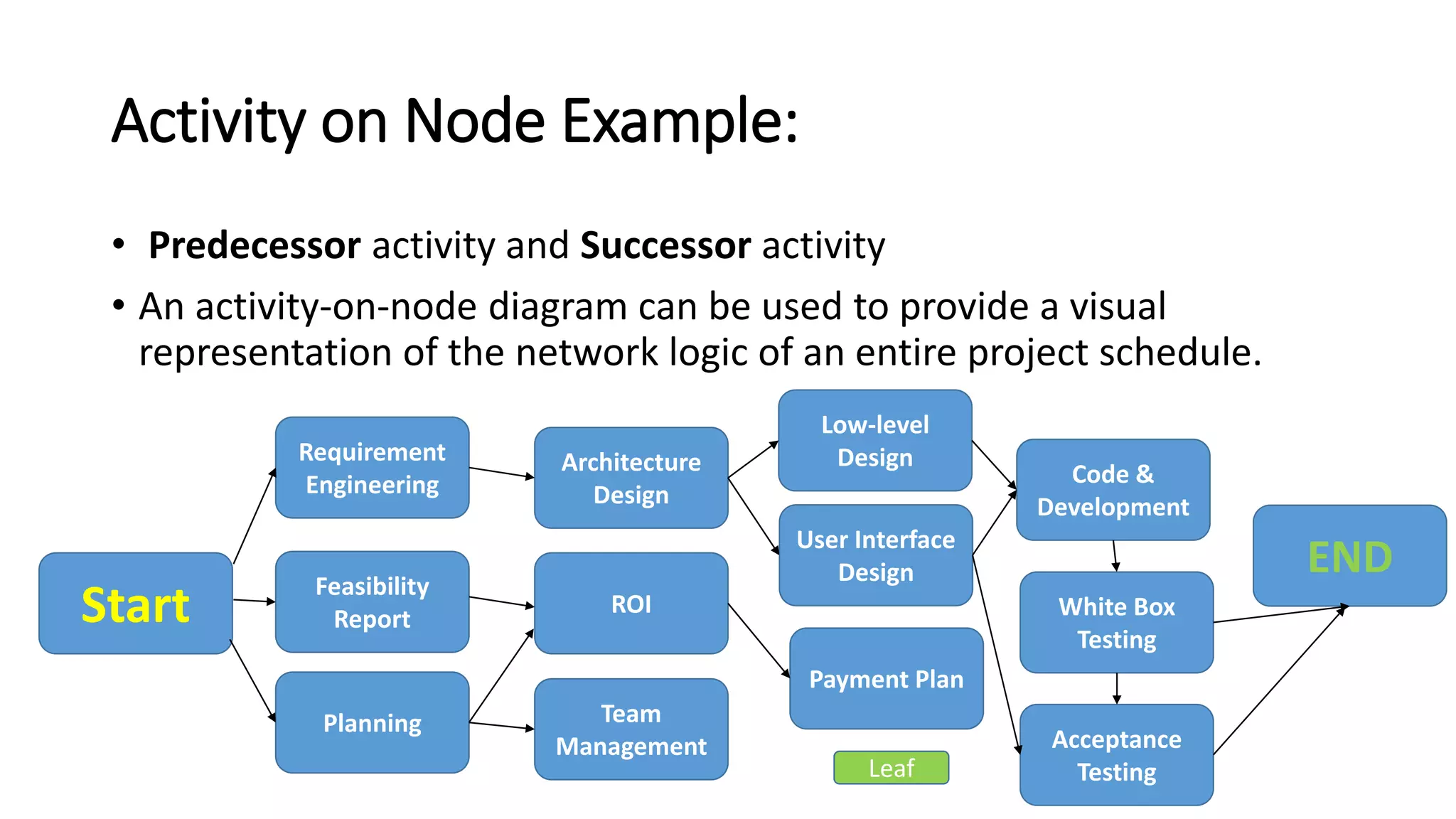

Activity on NodeExample:
• Predecessor activity and Successor activity
• An activity-on-node diagram can be used to provide a visual
representation of the network logic of an entire project schedule.
Start
Requirement
Engineering
Feasibility
Report
Architecture
Design
ROI
Team
Management
Low-level
Design
User Interface
Design
Code &
Development
Payment Plan
White Box
Testing
END
Planning
Acceptance
TestingLeaf
8.
Activity on NodeExample:

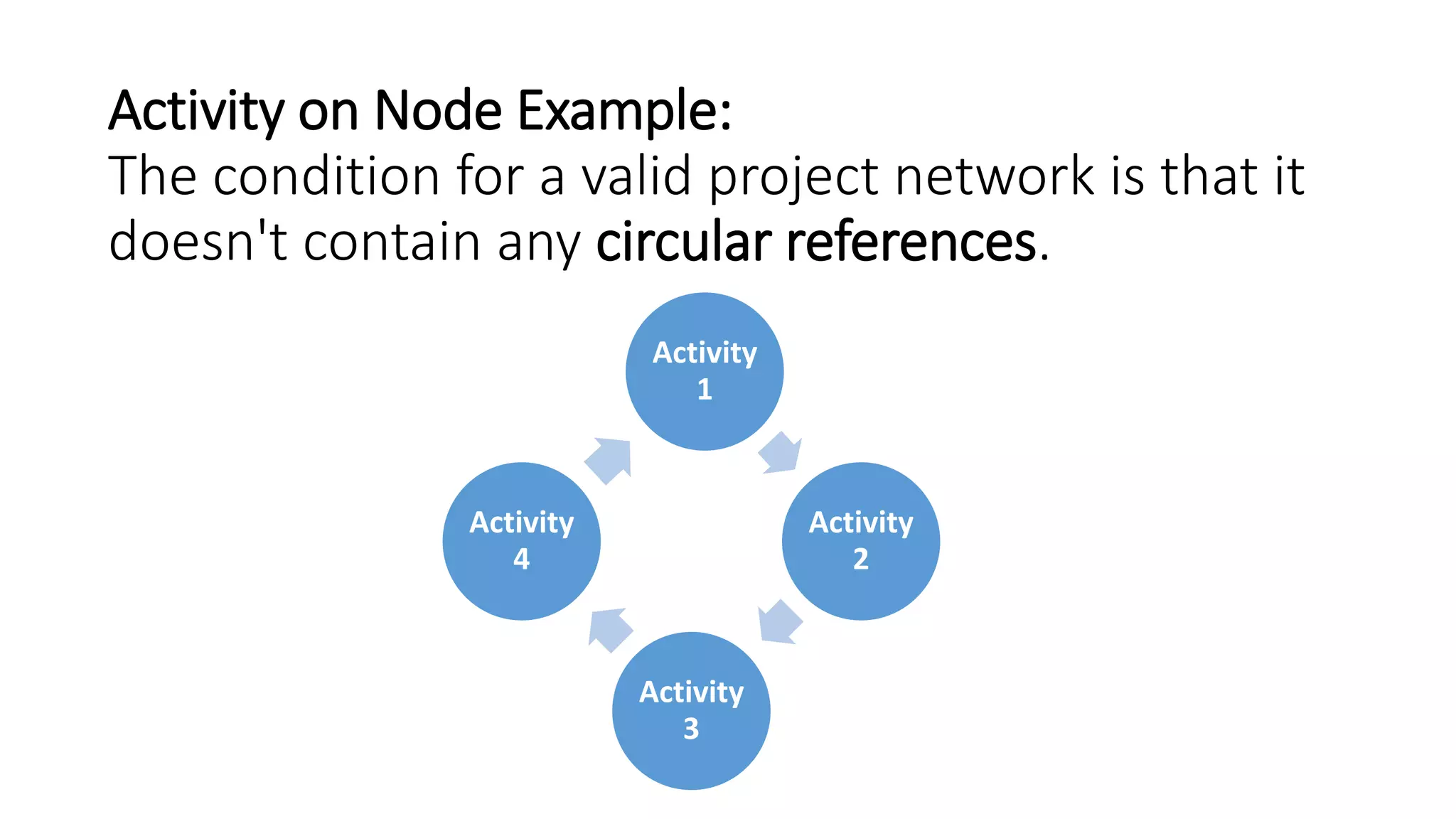

The condition for a valid project network is that it
doesn't contain any circular references.
Activity
1
Activity
2
Activity
3
Activity
4
9.

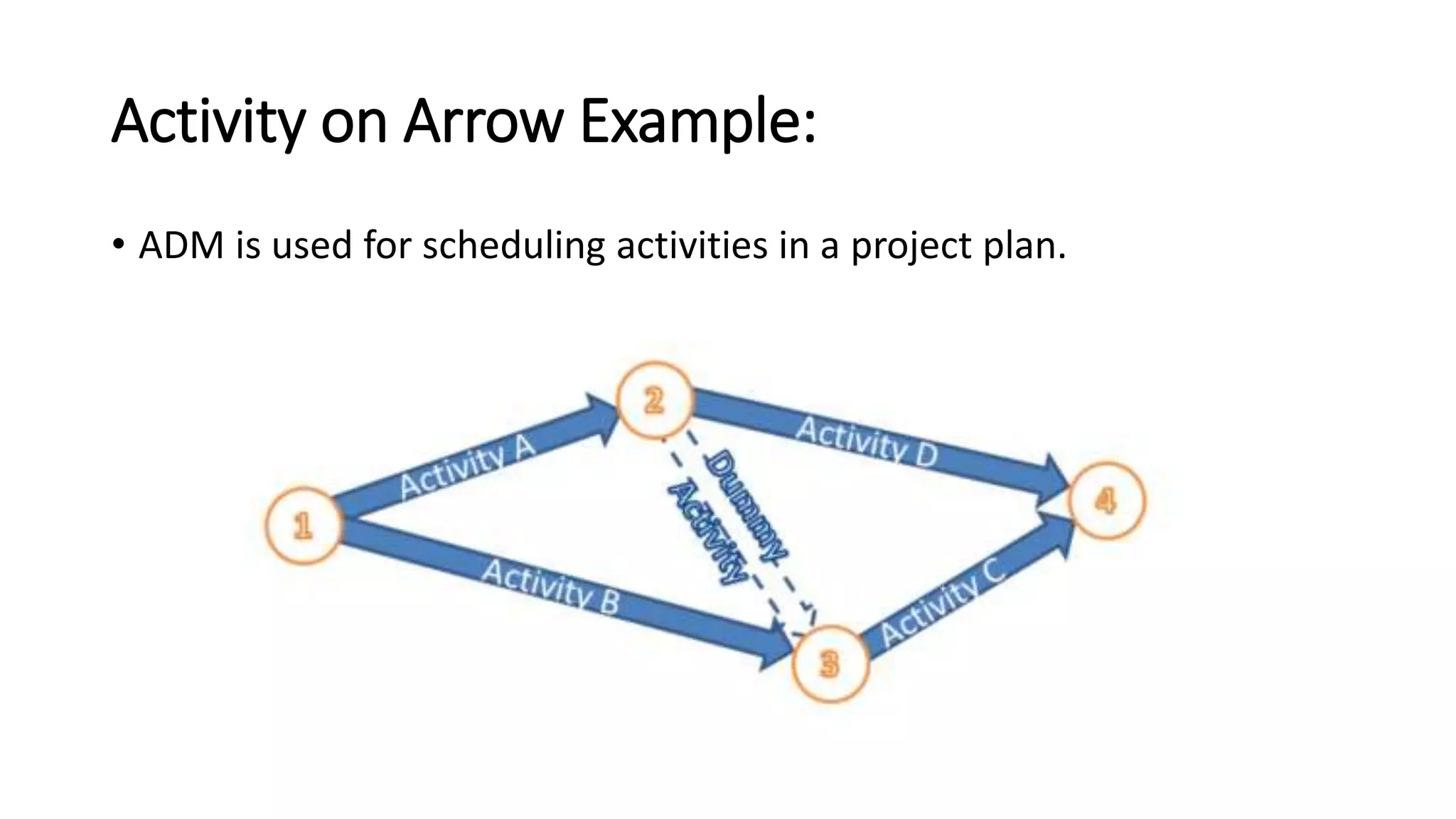

Activity on ArrowExample:
• ADM is used for scheduling activities in a project plan.
10.

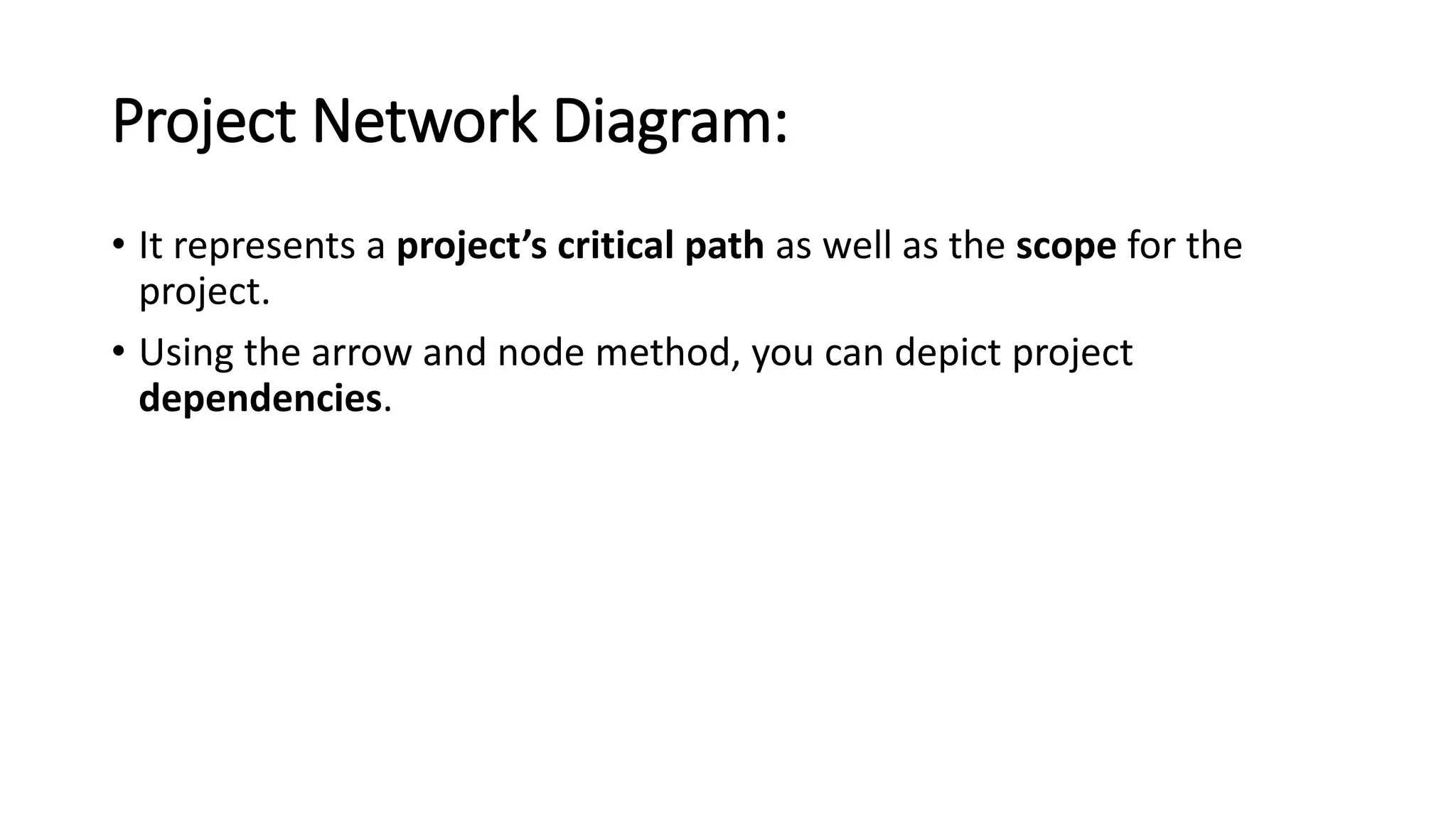

Project Network Diagram:
•It represents a project’s critical path as well as the scope for the
project.
• Using the arrow and node method, you can depict project
dependencies.
11.
Critical Path Method:

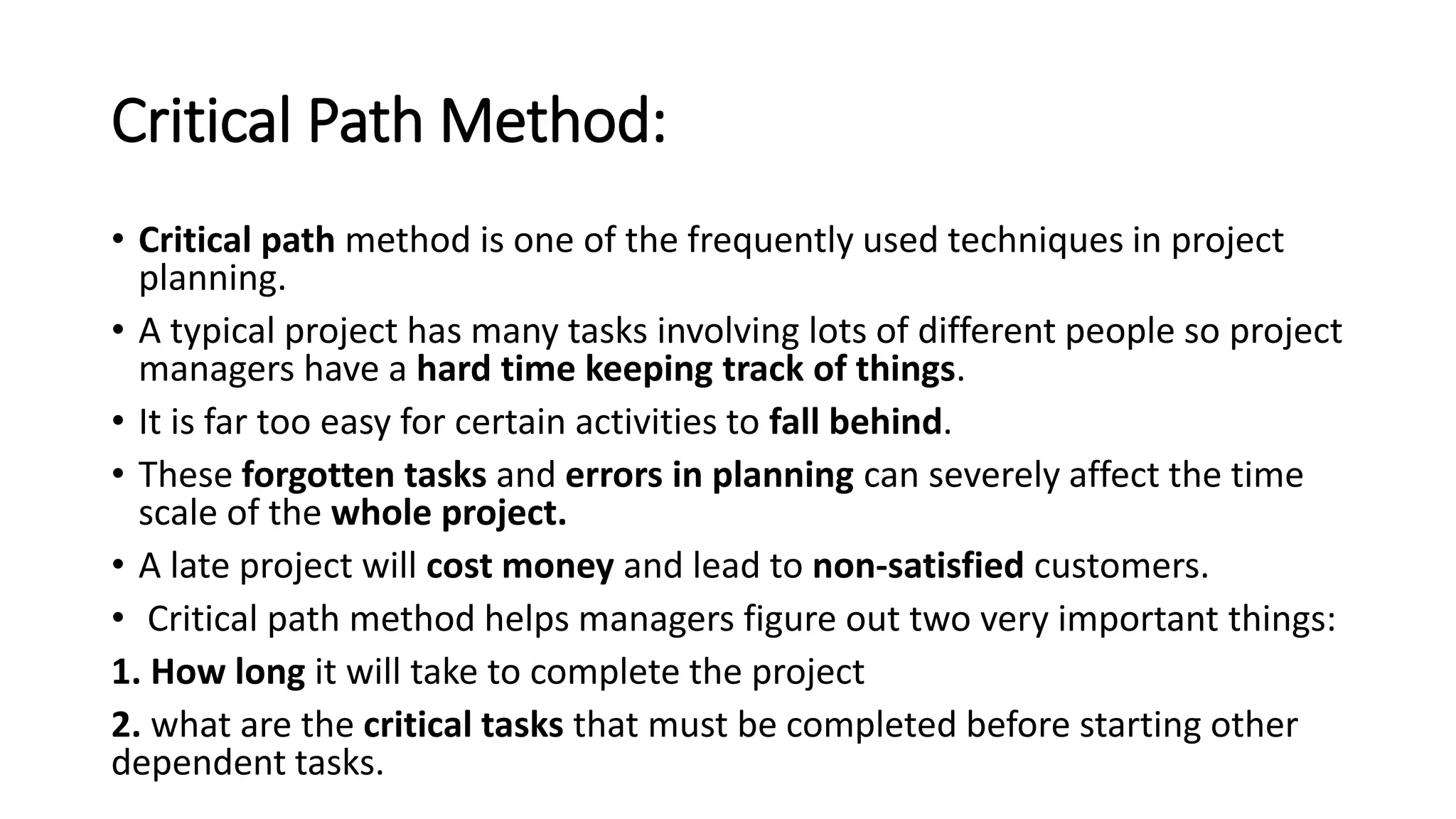

•Critical path method is one of the frequently used techniques in project
planning.
• A typical project has many tasks involving lots of different people so project
managers have a hard time keeping track of things.
• It is far too easy for certain activities to fall behind.
• These forgotten tasks and errors in planning can severely affect the time
scale of the whole project.
• A late project will cost money and lead to non-satisfied customers.
• Critical path method helps managers figure out two very important things:
1. How long it will take to complete the project
2. what are the critical tasks that must be completed before starting other
dependent tasks.
12.
Critical Path Method:

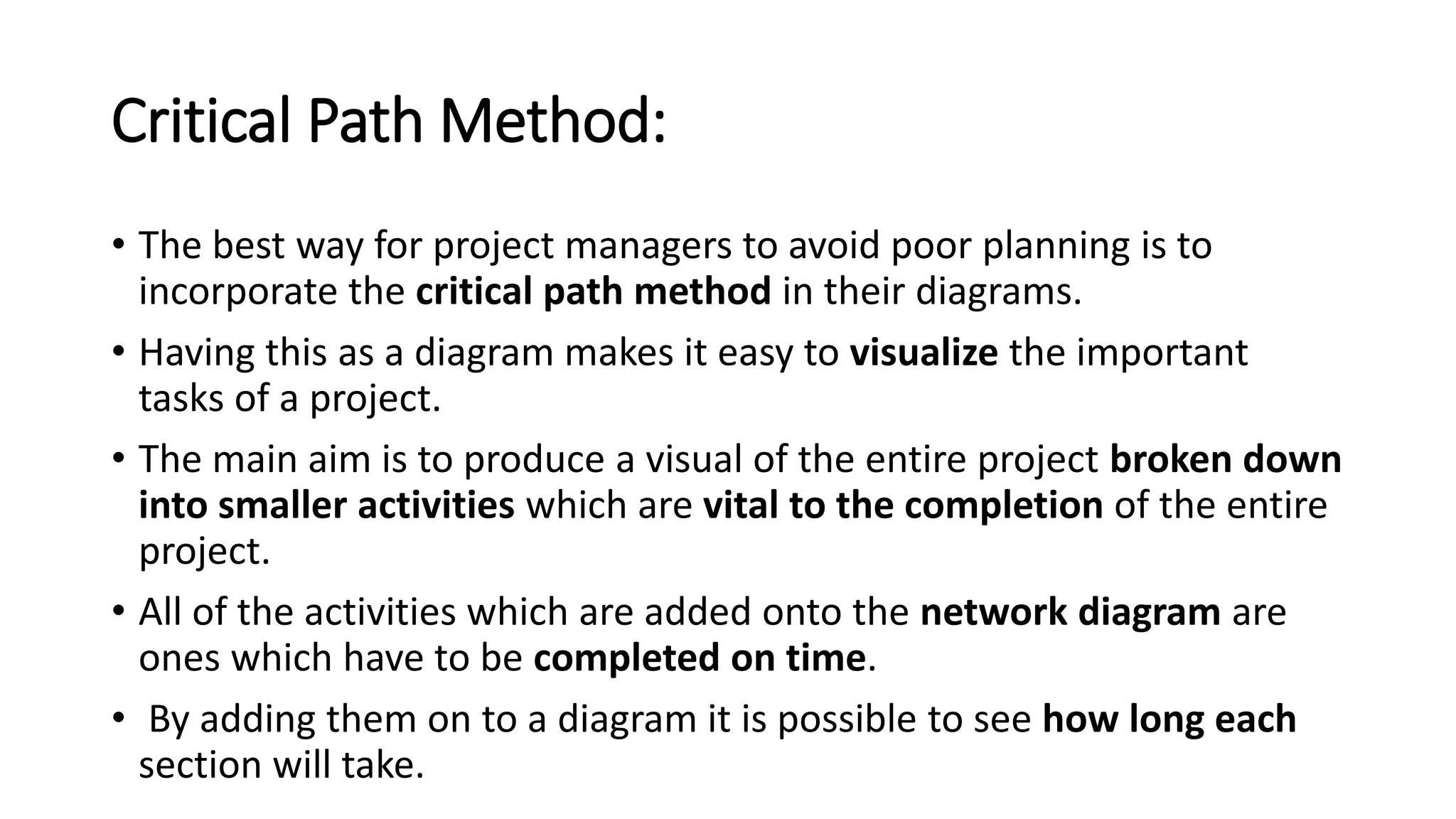

•The best way for project managers to avoid poor planning is to
incorporate the critical path method in their diagrams.
• Having this as a diagram makes it easy to visualize the important
tasks of a project.
• The main aim is to produce a visual of the entire project broken down
into smaller activities which are vital to the completion of the entire
project.
• All of the activities which are added onto the network diagram are
ones which have to be completed on time.
• By adding them on to a diagram it is possible to see how long each
section will take.
13.

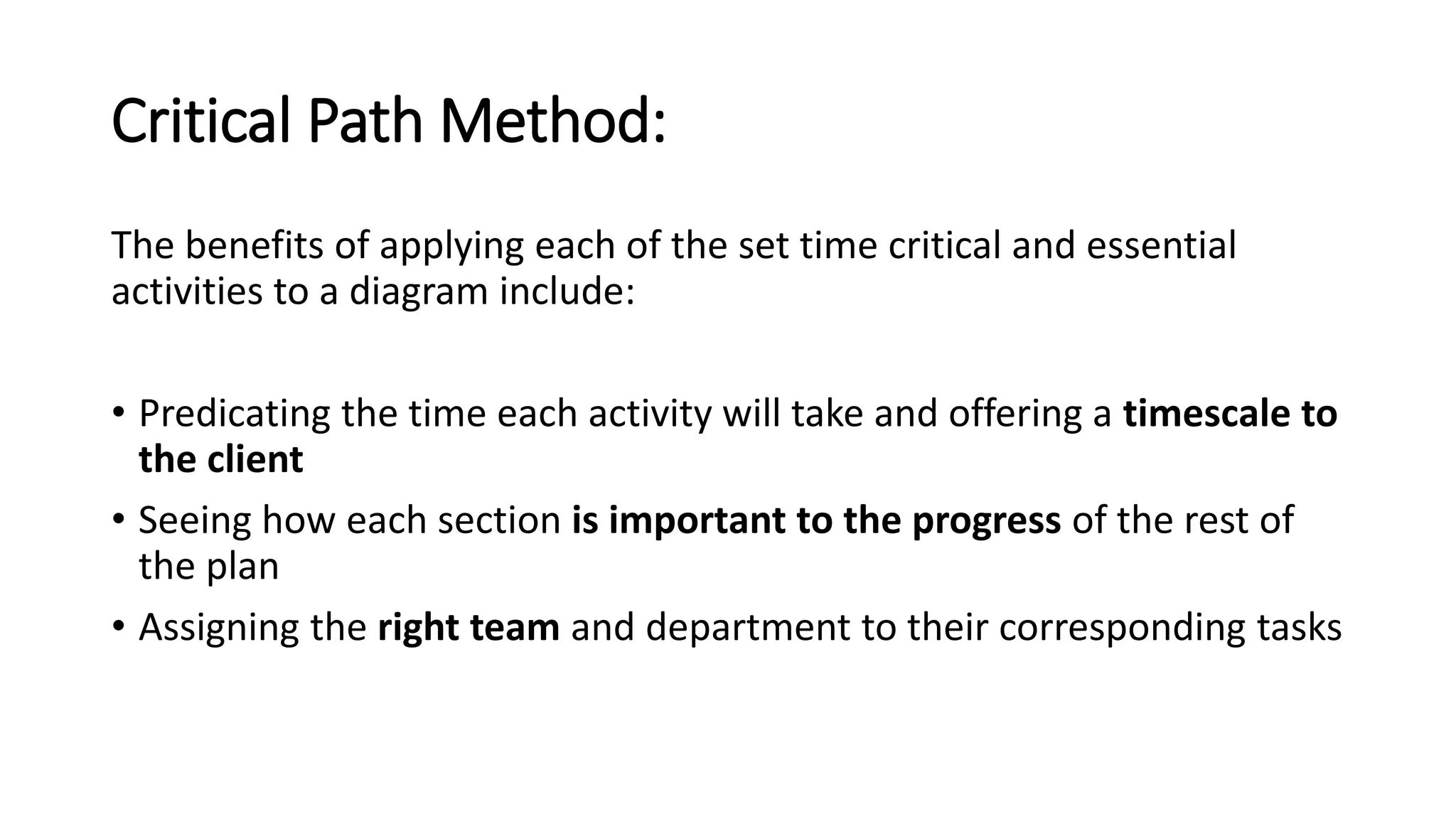

Critical Path Method:
Thebenefits of applying each of the set time critical and essential
activities to a diagram include:
• Predicating the time each activity will take and offering a timescale to
the client
• Seeing how each section is important to the progress of the rest of
the plan
• Assigning the right team and department to their corresponding tasks

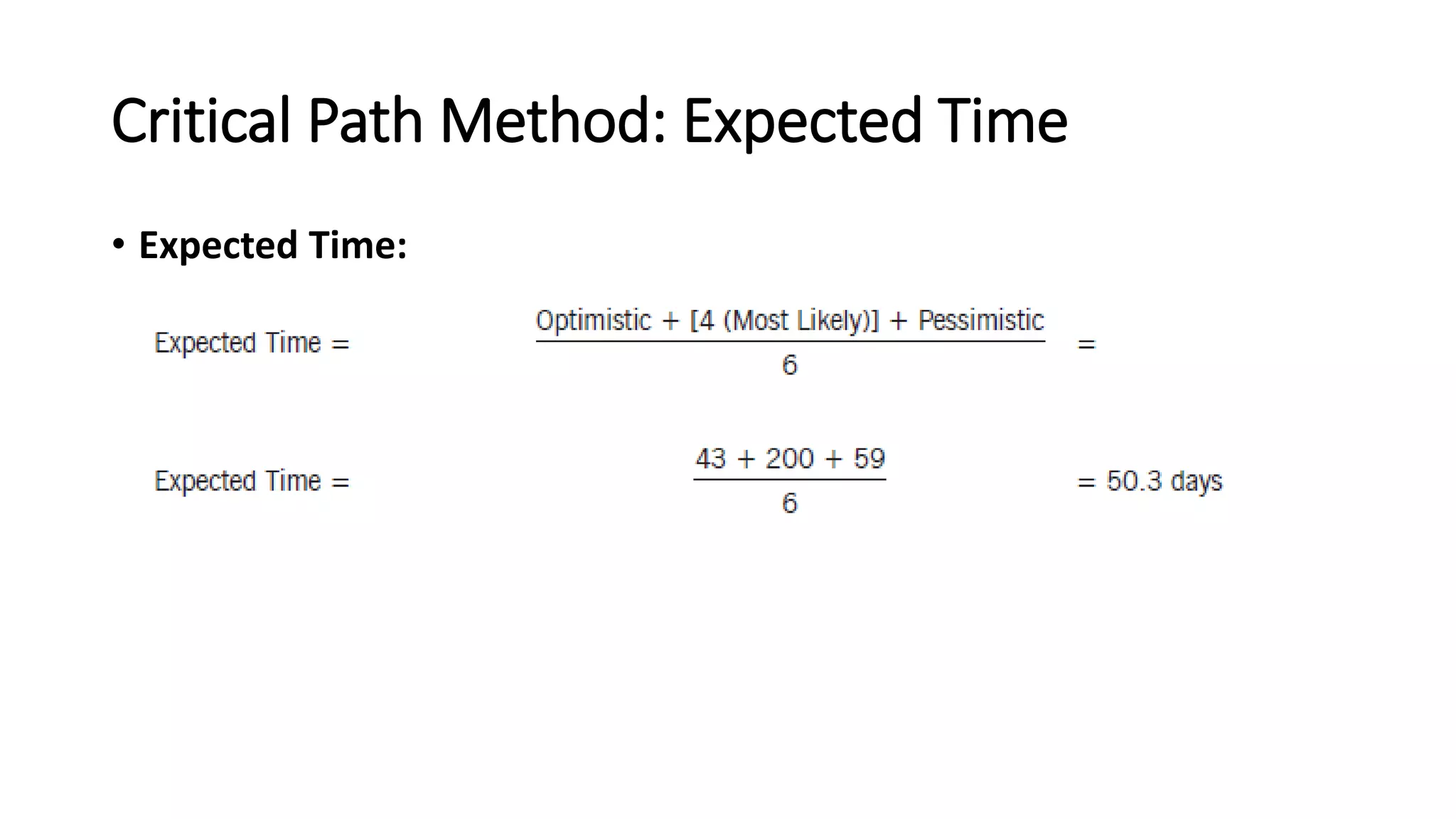

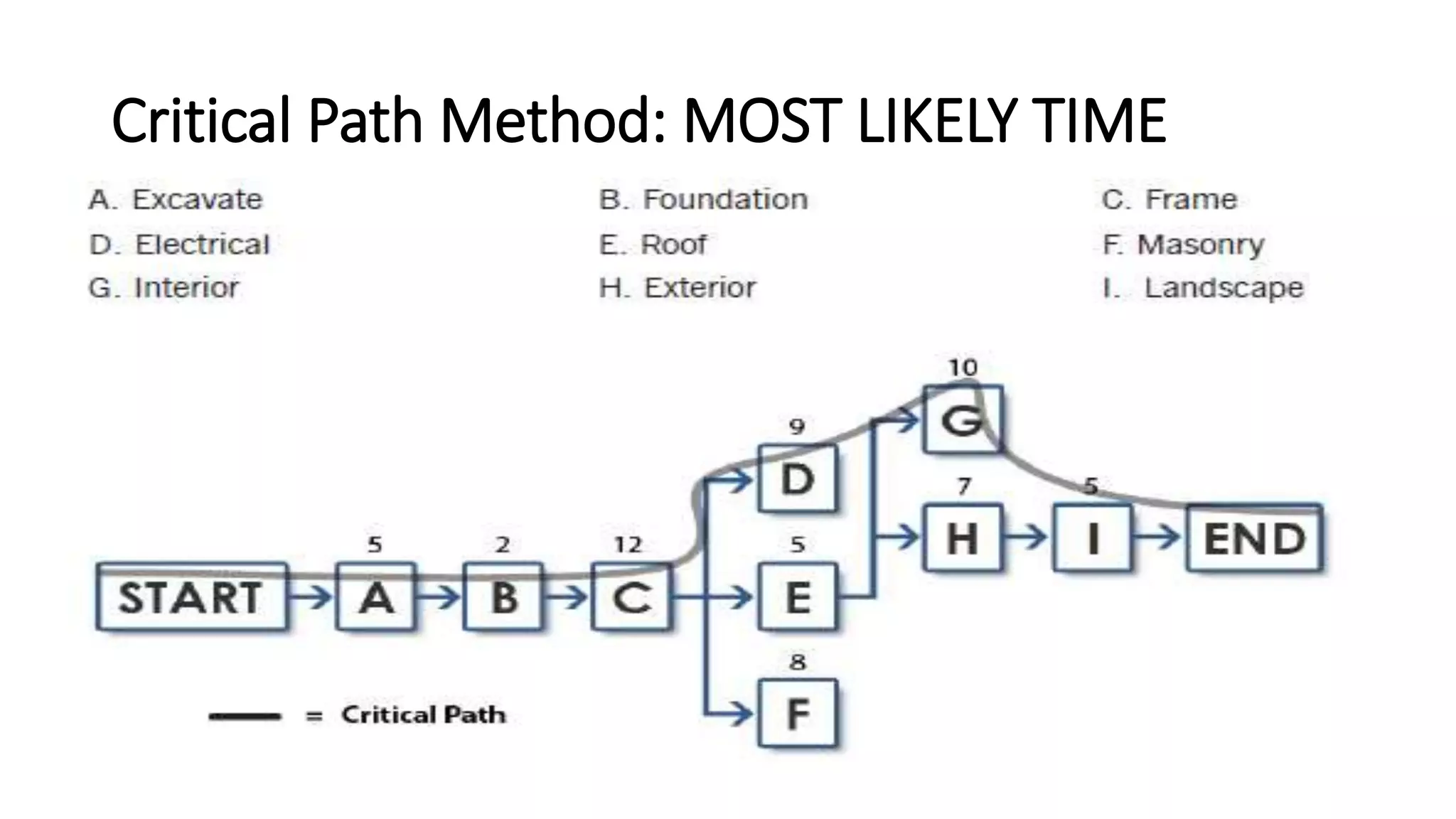

Critical Path Method:MOST LIKELY TIME
• The team’s job is to take note of which of the nodes D, E, and F, will
be taking the most amount of time, and which of those nodes is
expected to take the least amount of time.
• This is essential when creating the Critical Path.

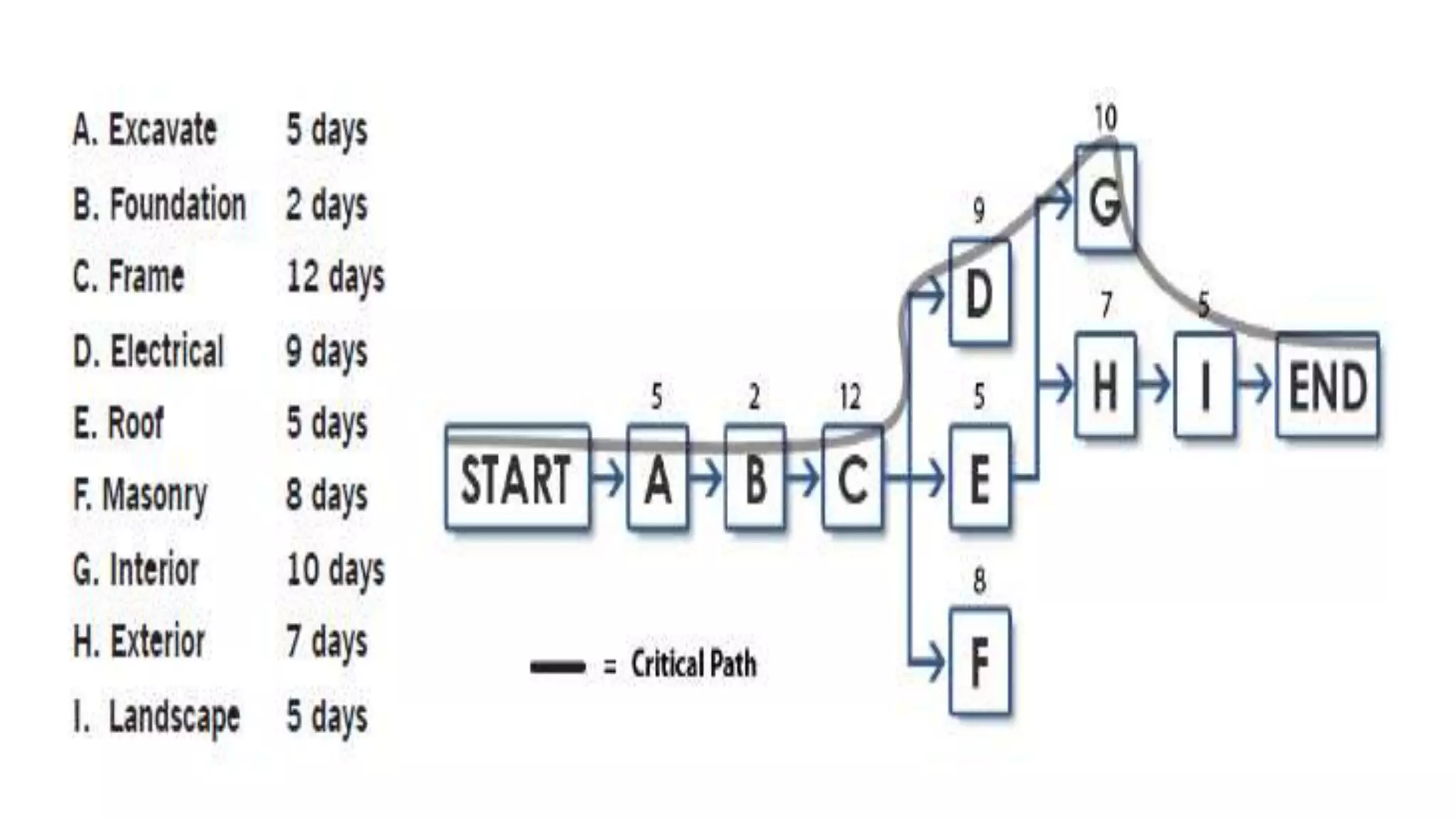

• Nodes A, B, and C run in series, so the critical path is straightforward.
17.

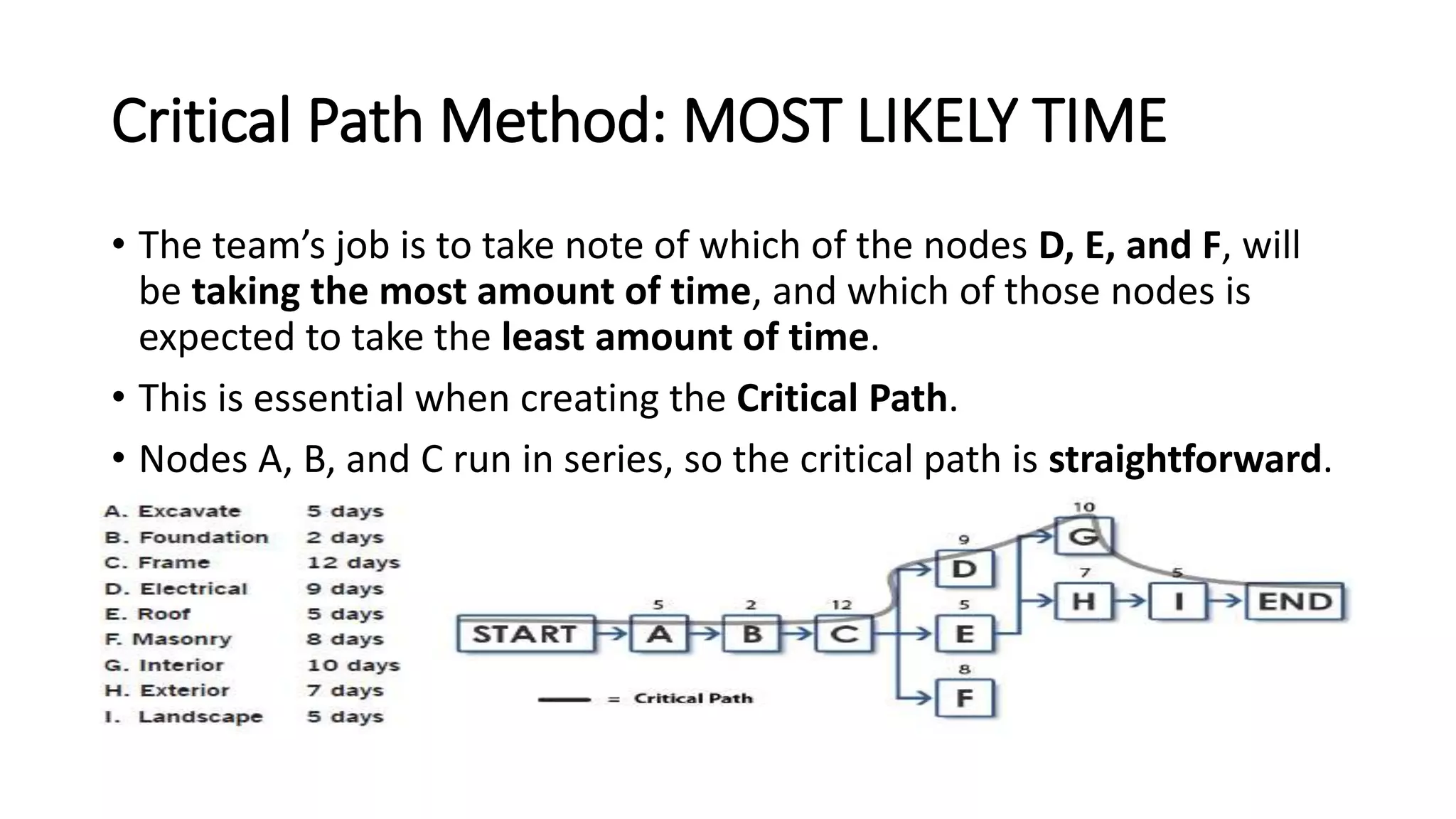

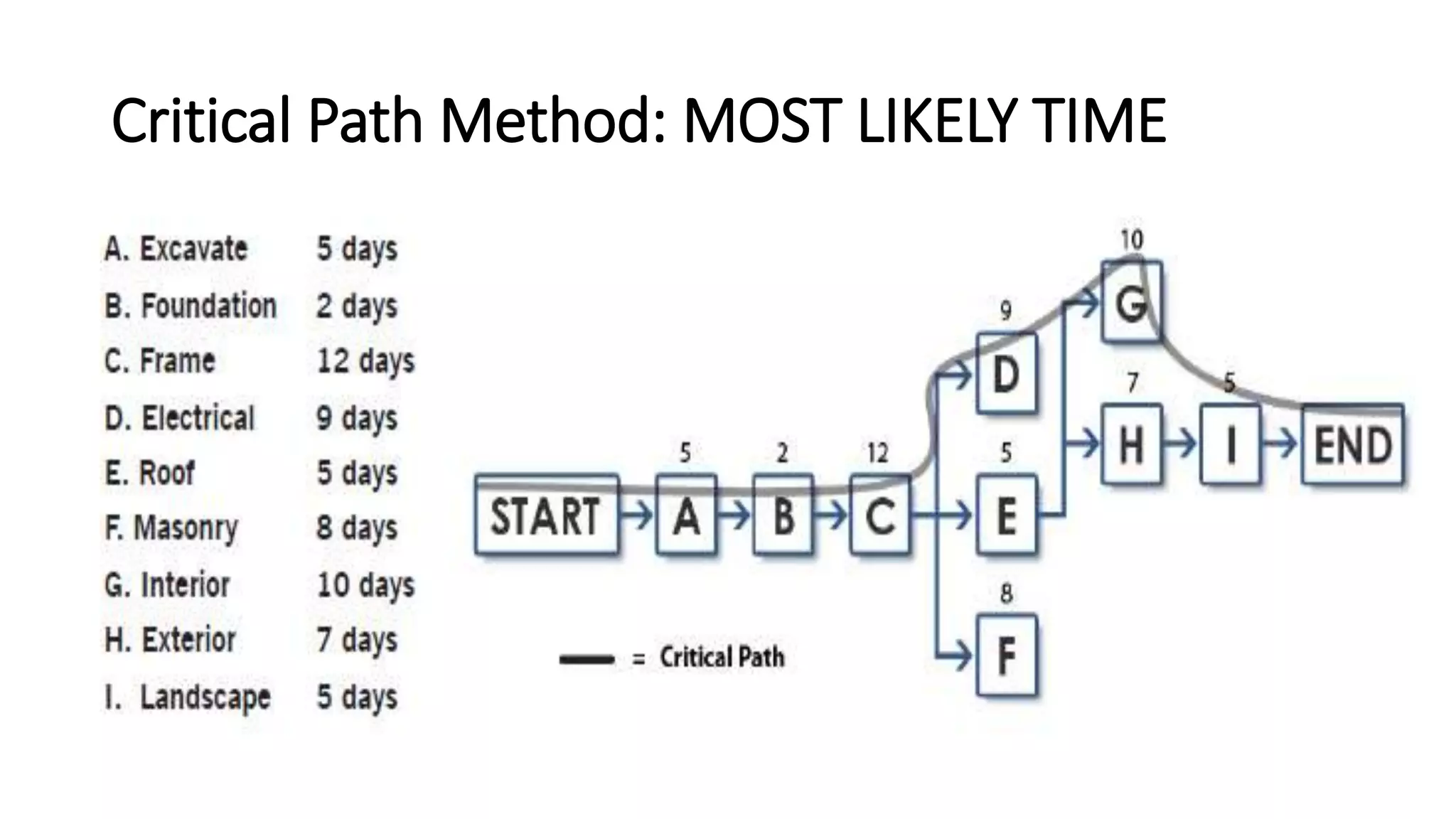

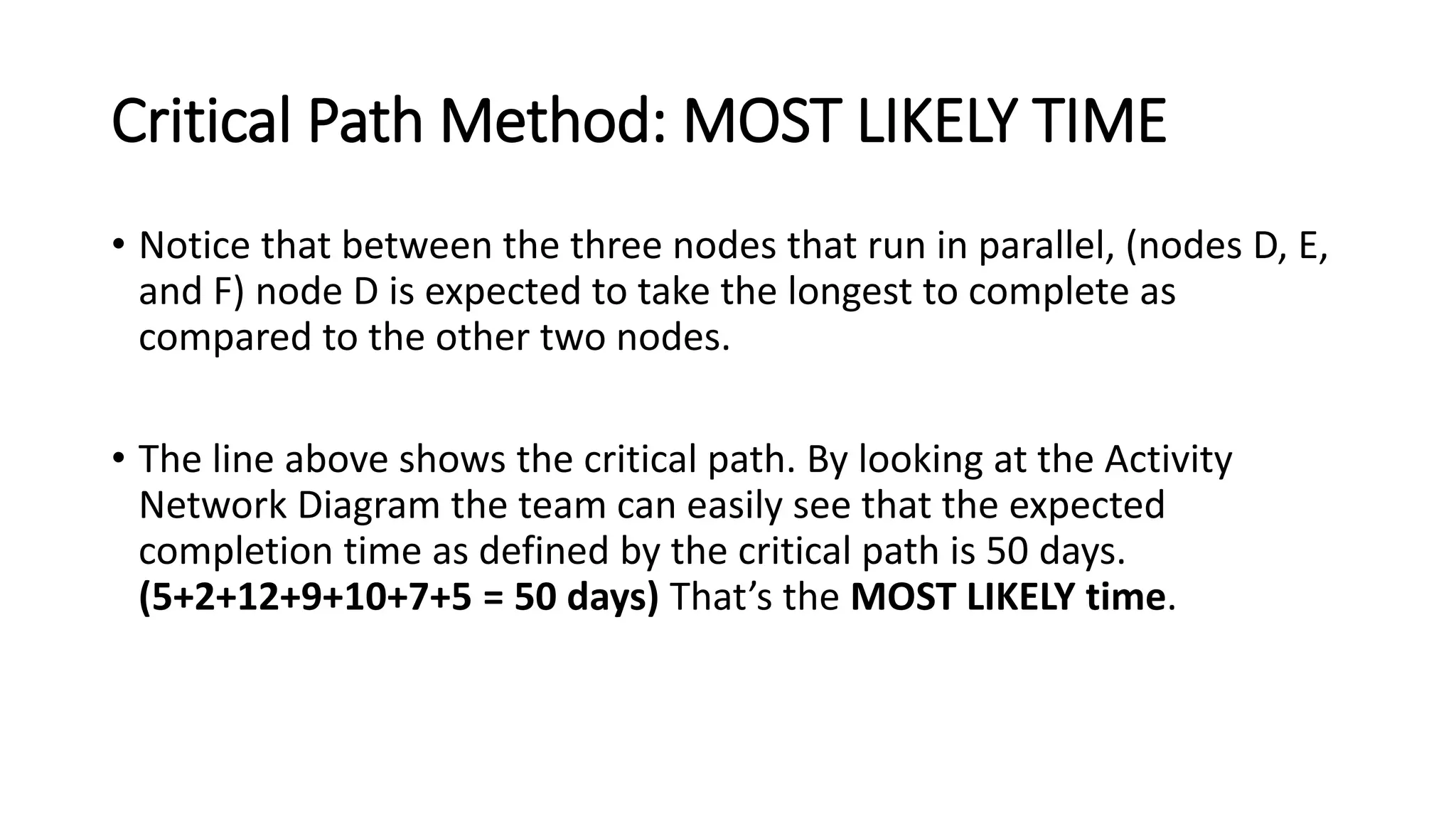

Critical Path Method:MOST LIKELY TIME
• Notice that between the three nodes that run in parallel, (nodes D, E,
and F) node D is expected to take the longest to complete as
compared to the other two nodes.
• The line above shows the critical path. By looking at the Activity
Network Diagram the team can easily see that the expected
completion time as defined by the critical path is 50 days.
(5+2+12+9+10+7+5 = 50 days) That’s the MOST LIKELY time.
18.

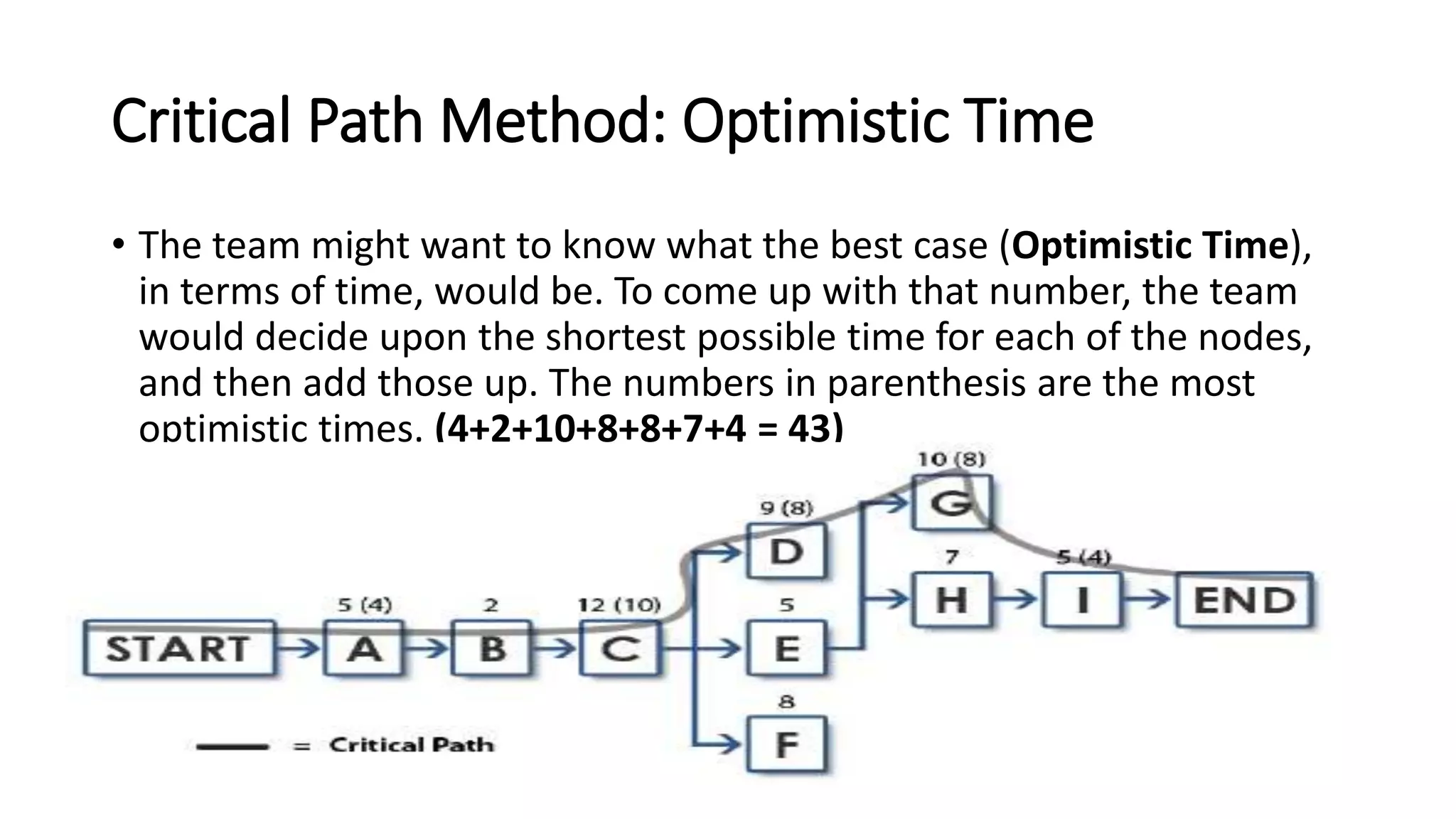

Critical Path Method:Optimistic Time
• The team might want to know what the best case (Optimistic Time),
in terms of time, would be. To come up with that number, the team
would decide upon the shortest possible time for each of the nodes,
and then add those up. The numbers in parenthesis are the most
optimistic times. (4+2+10+8+8+7+4 = 43)
19.

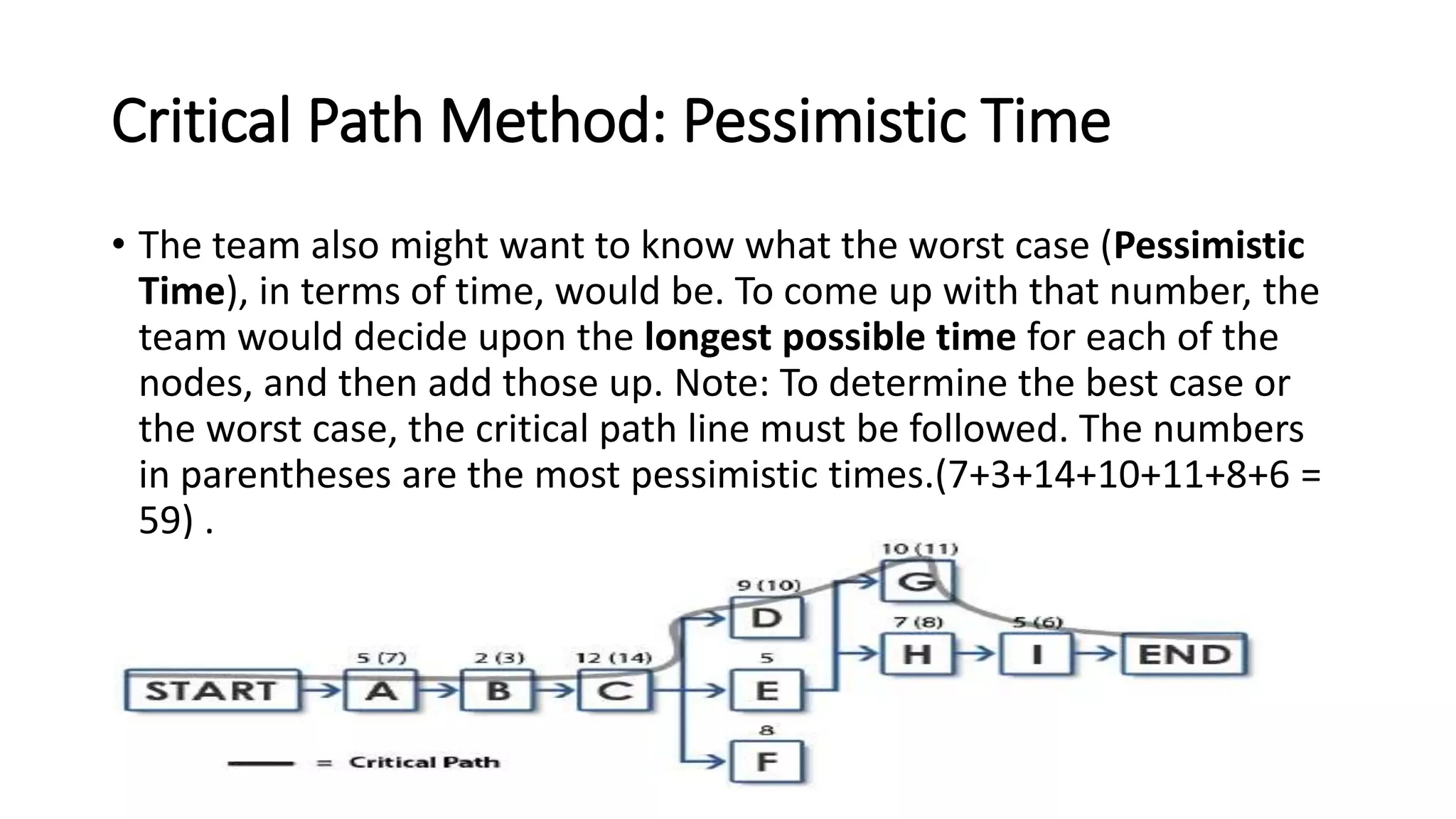

Critical Path Method:Pessimistic Time
• The team also might want to know what the worst case (Pessimistic
Time), in terms of time, would be. To come up with that number, the
team would decide upon the longest possible time for each of the
nodes, and then add those up. Note: To determine the best case or
the worst case, the critical path line must be followed. The numbers
in parentheses are the most pessimistic times.(7+3+14+10+11+8+6 =
59) .

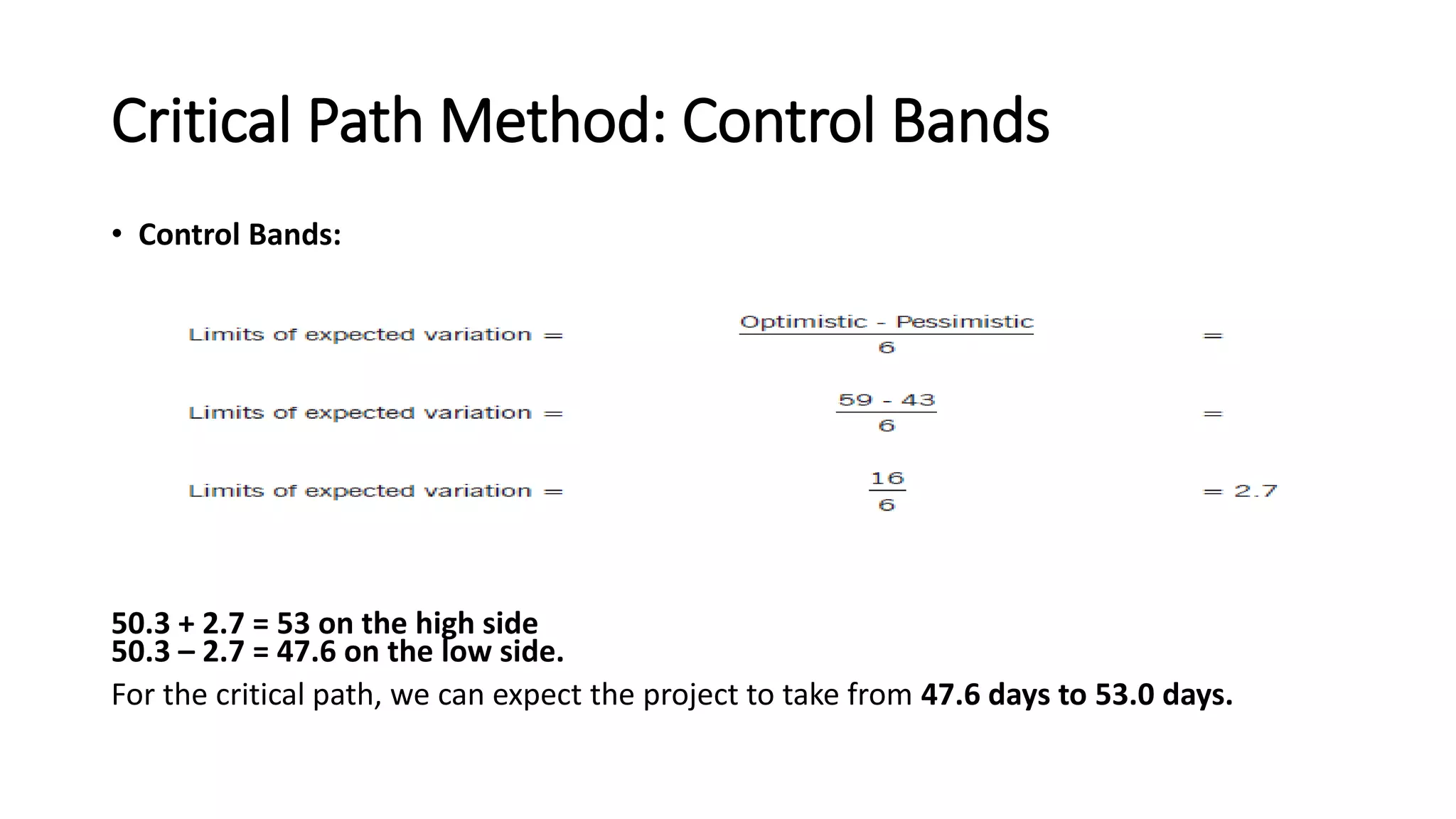

Critical Path Method:Control Bands
• Control Bands:
50.3 + 2.7 = 53 on the high side
50.3 – 2.7 = 47.6 on the low side.
For the critical path, we can expect the project to take from 47.6 days to 53.0 days.
22.

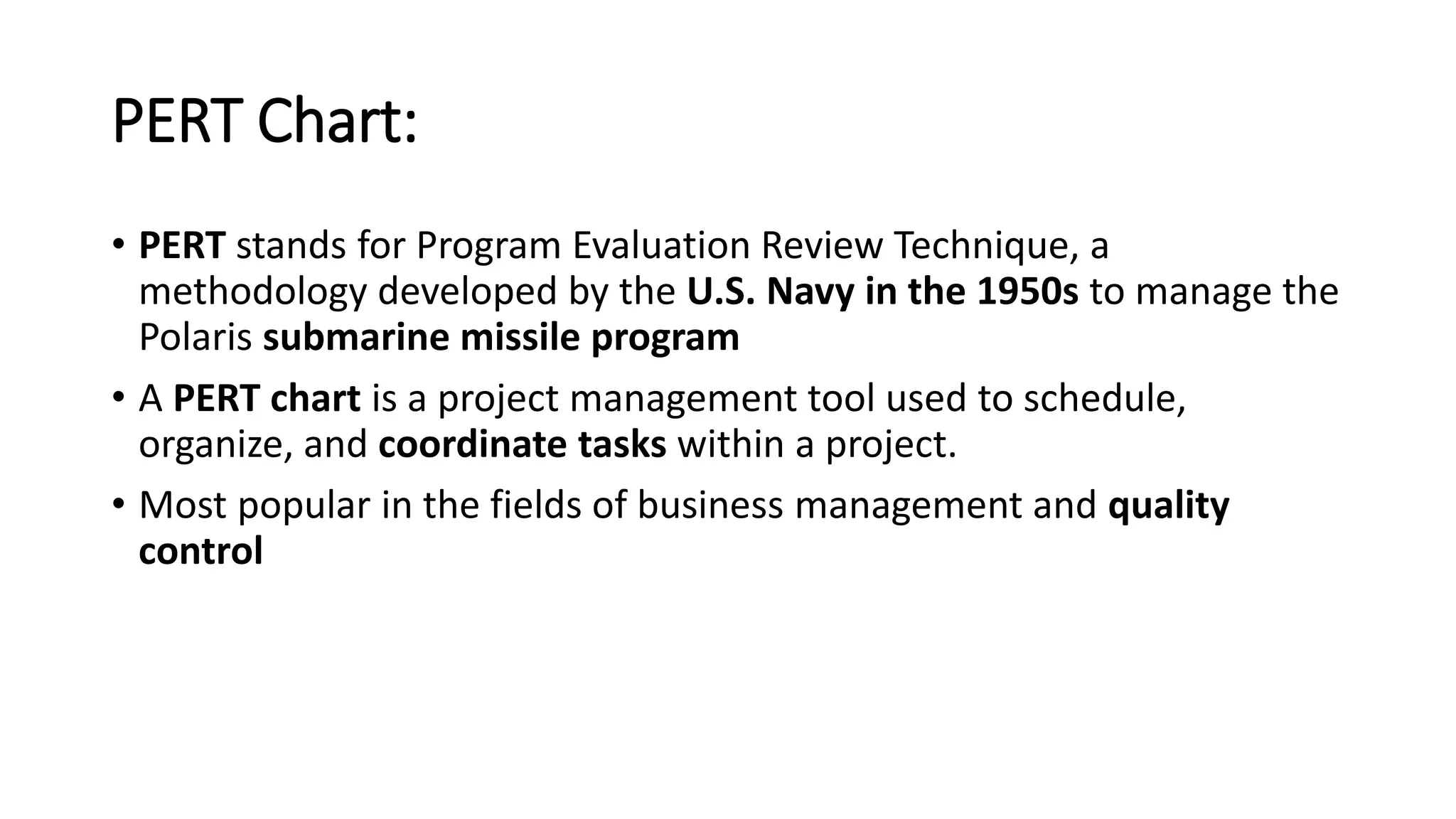

PERT Chart:
• PERTstands for Program Evaluation Review Technique, a
methodology developed by the U.S. Navy in the 1950s to manage the
Polaris submarine missile program
• A PERT chart is a project management tool used to schedule,
organize, and coordinate tasks within a project.
• Most popular in the fields of business management and quality
control
24.

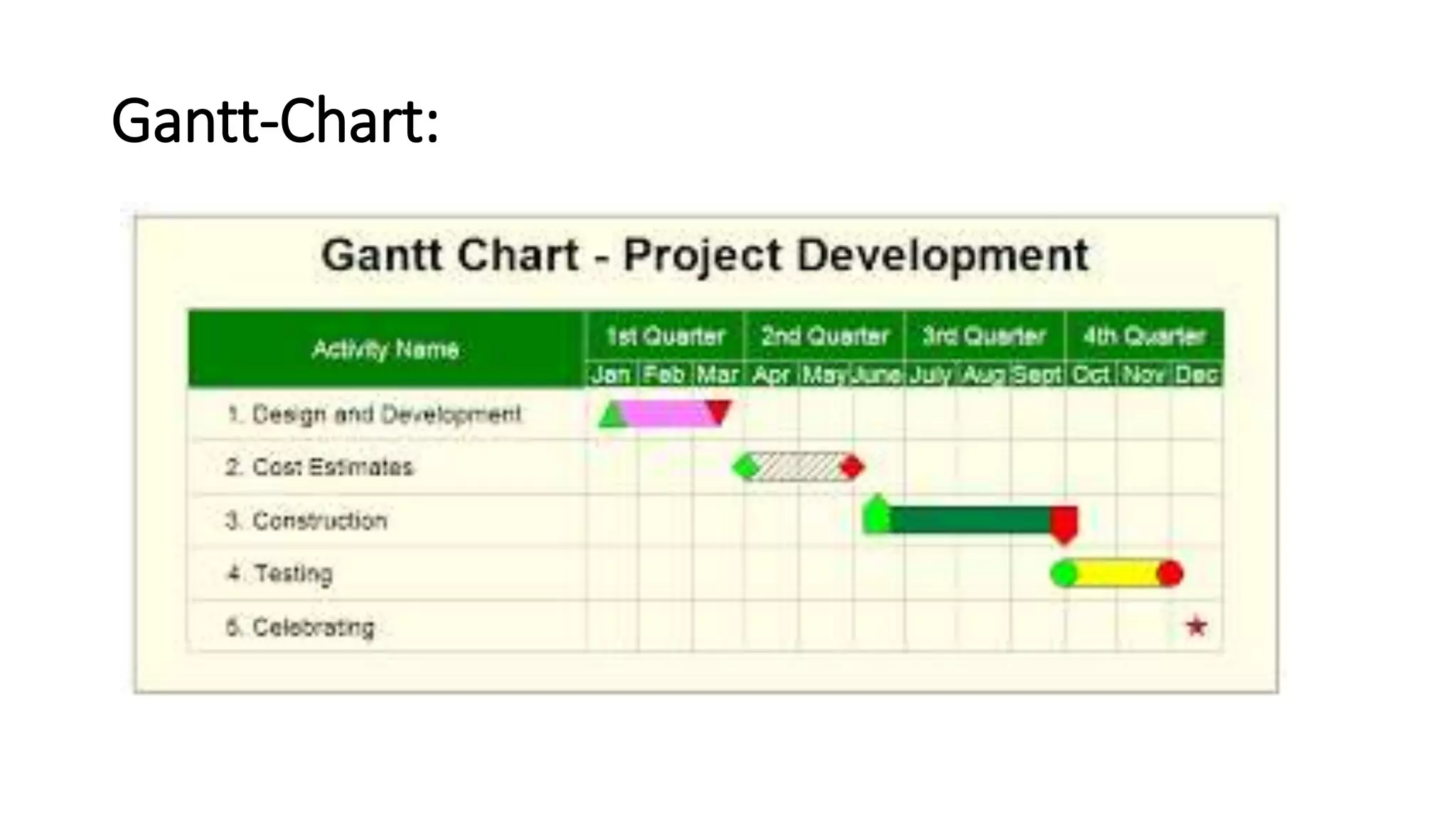

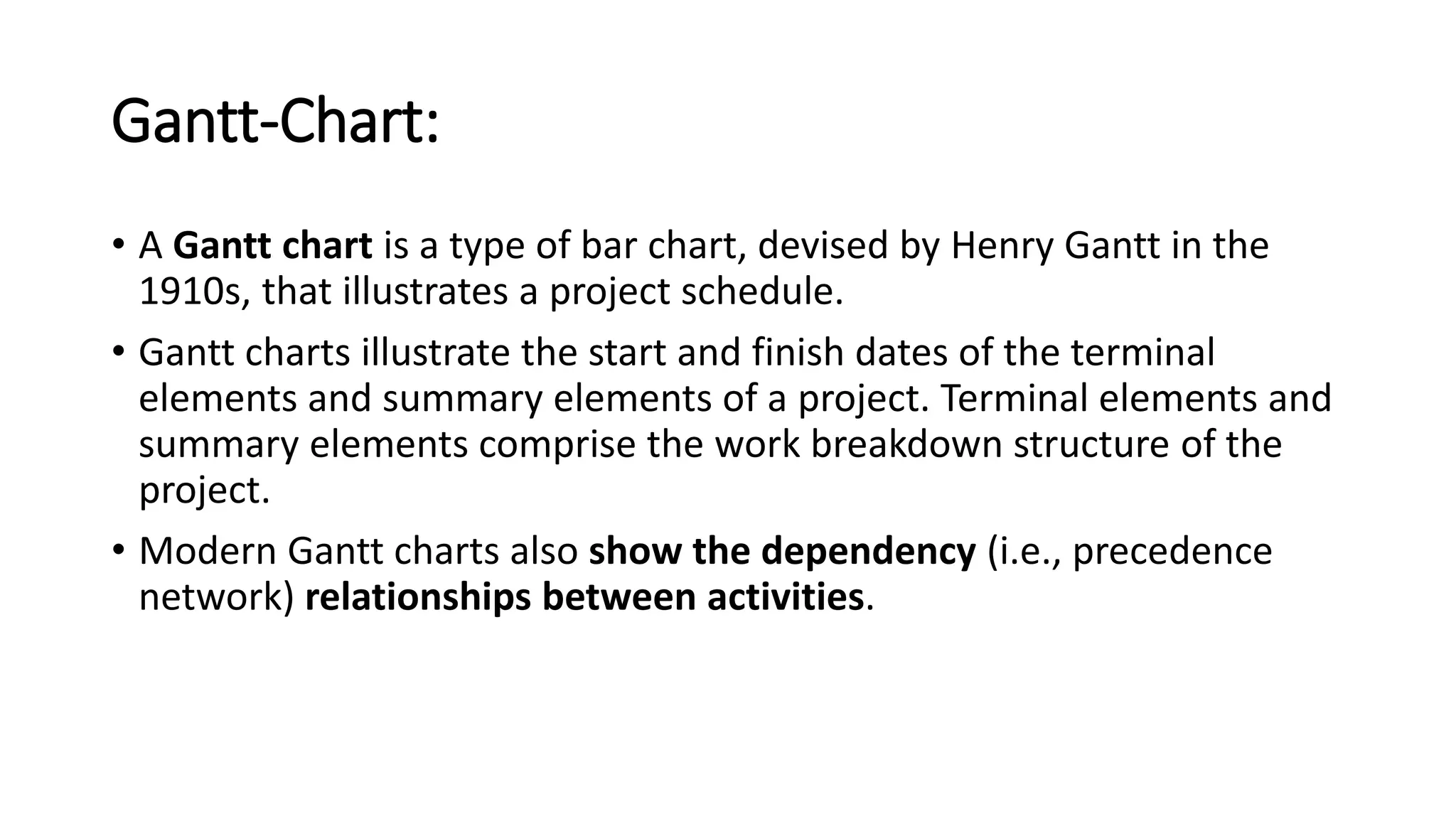

Gantt-Chart:
• A Ganttchart is a type of bar chart, devised by Henry Gantt in the
1910s, that illustrates a project schedule.
• Gantt charts illustrate the start and finish dates of the terminal
elements and summary elements of a project. Terminal elements and
summary elements comprise the work breakdown structure of the
project.
• Modern Gantt charts also show the dependency (i.e., precedence
network) relationships between activities.

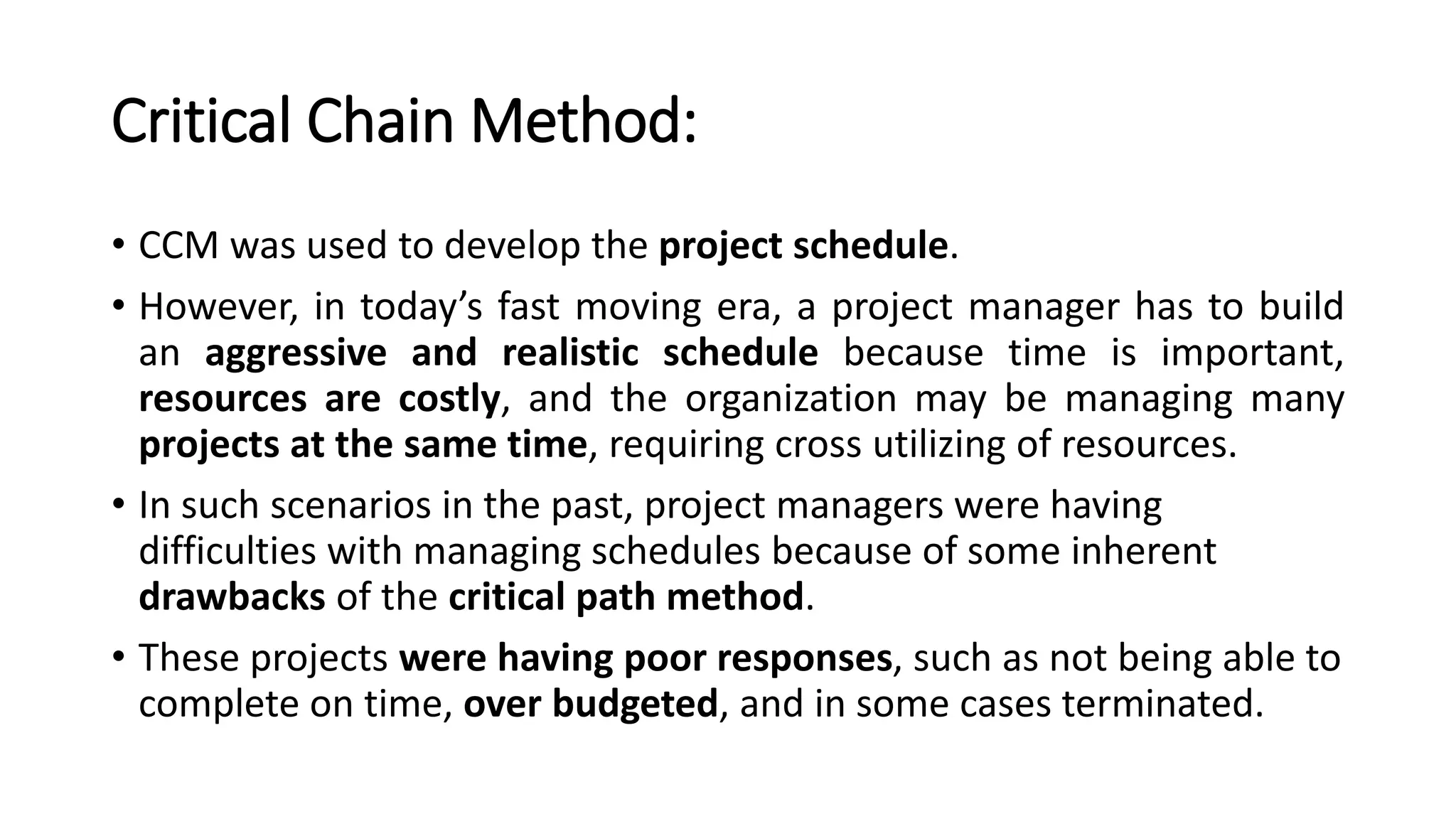

Critical Chain Method:
•CCM was used to develop the project schedule.
• However, in today’s fast moving era, a project manager has to build
an aggressive and realistic schedule because time is important,
resources are costly, and the organization may be managing many
projects at the same time, requiring cross utilizing of resources.
• In such scenarios in the past, project managers were having
difficulties with managing schedules because of some inherent
drawbacks of the critical path method.
• These projects were having poor responses, such as not being able to
complete on time, over budgeted, and in some cases terminated.
30.

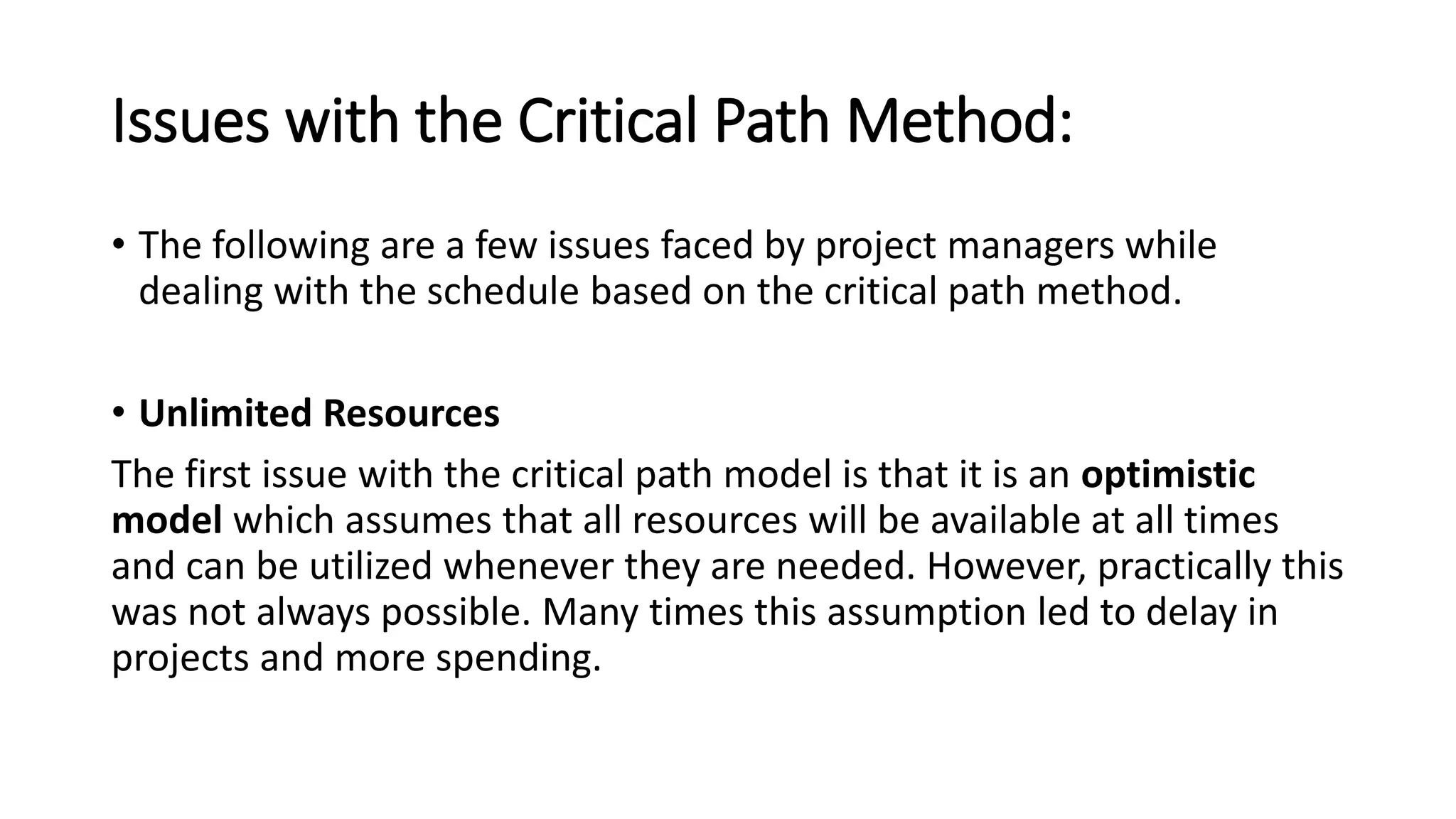

Issues with theCritical Path Method:
• The following are a few issues faced by project managers while
dealing with the schedule based on the critical path method.
• Unlimited Resources
The first issue with the critical path model is that it is an optimistic
model which assumes that all resources will be available at all times
and can be utilized whenever they are needed. However, practically this
was not always possible. Many times this assumption led to delay in
projects and more spending.
31.

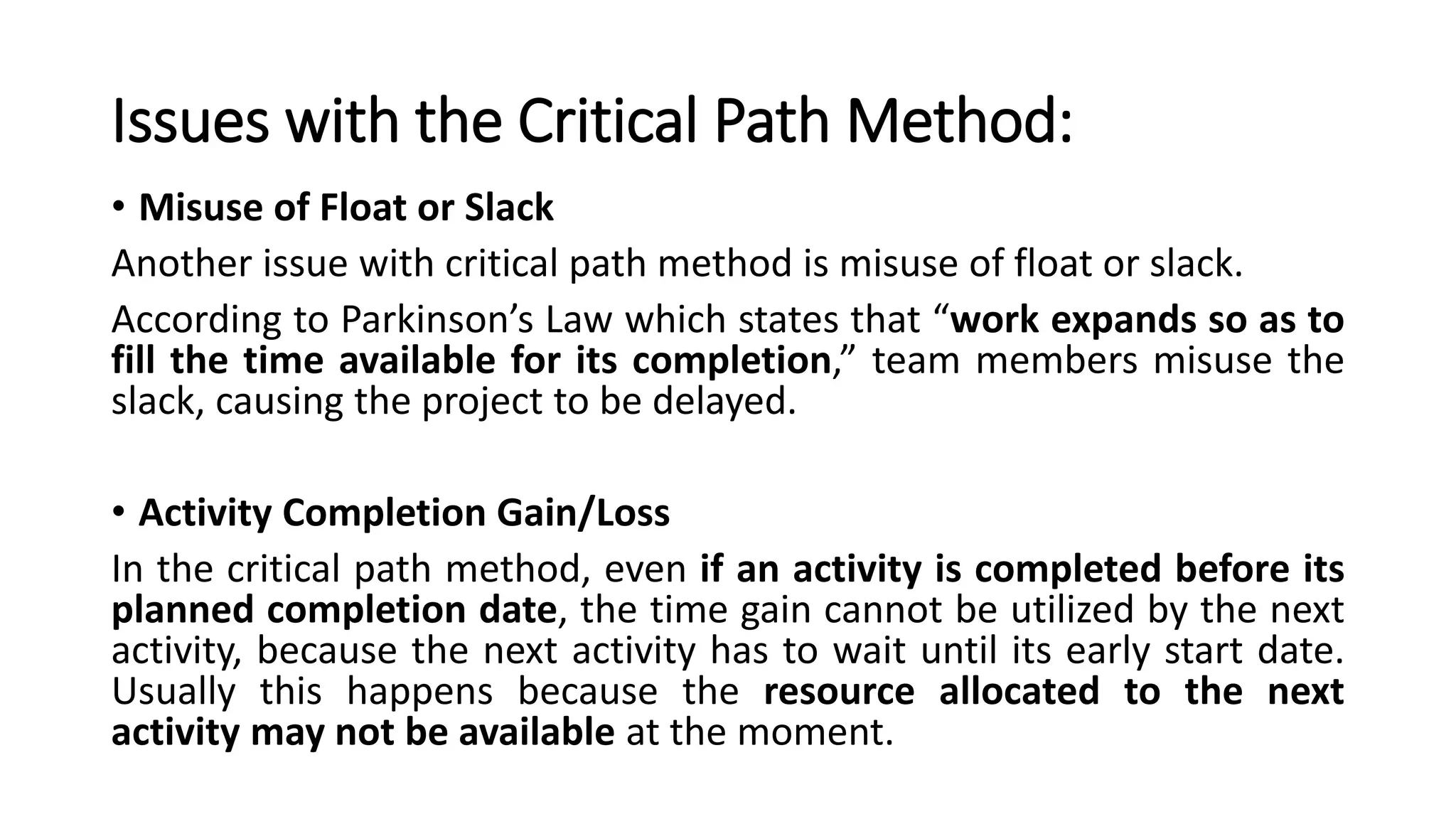

Issues with theCritical Path Method:
• Misuse of Float or Slack
Another issue with critical path method is misuse of float or slack.
According to Parkinson’s Law which states that “work expands so as to
fill the time available for its completion,” team members misuse the
slack, causing the project to be delayed.
• Activity Completion Gain/Loss
In the critical path method, even if an activity is completed before its
planned completion date, the time gain cannot be utilized by the next
activity, because the next activity has to wait until its early start date.
Usually this happens because the resource allocated to the next
activity may not be available at the moment.
32.
Critical Chain Method:

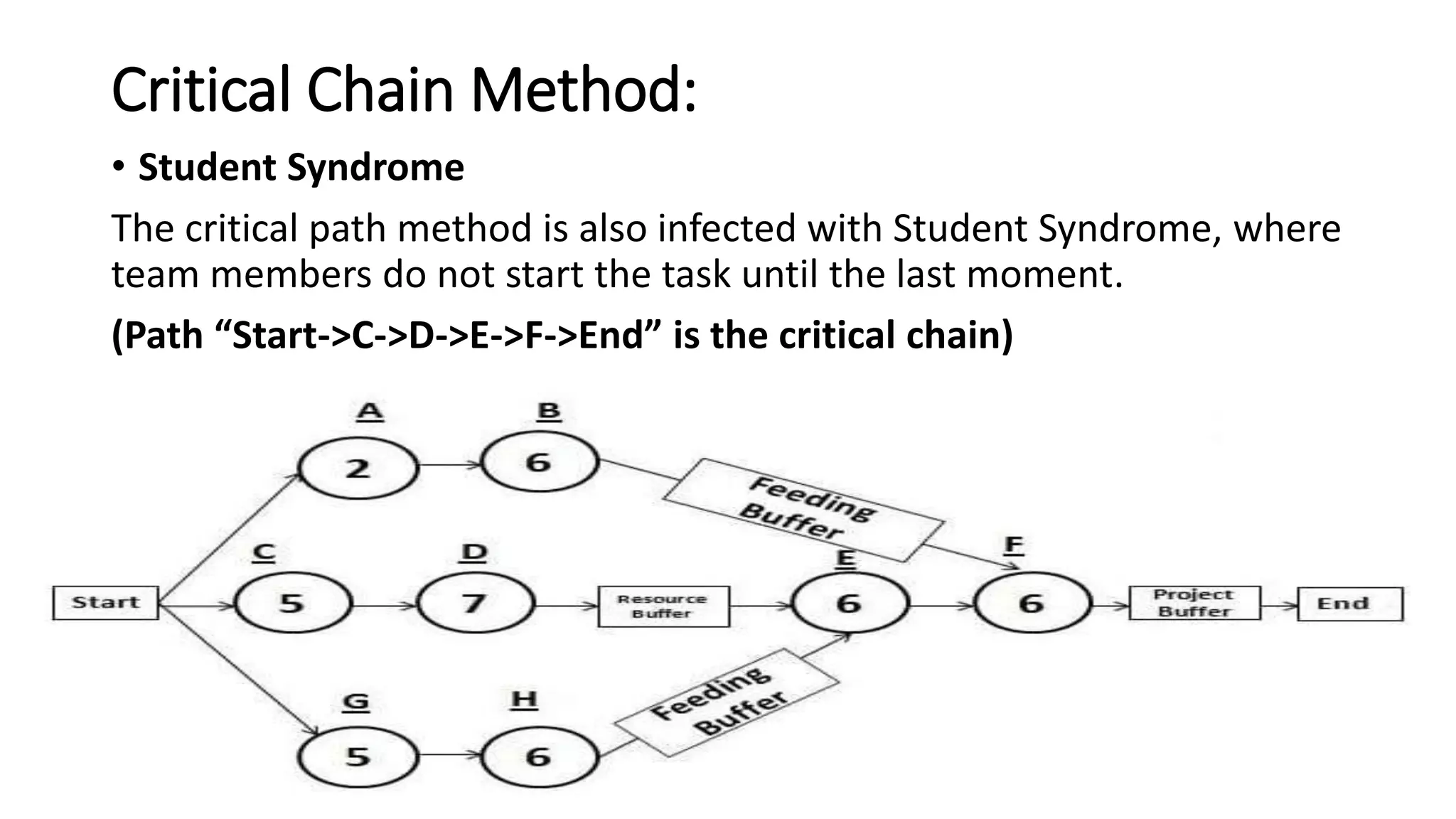

•Student Syndrome
The critical path method is also infected with Student Syndrome, where
team members do not start the task until the last moment.
(Path “Start->C->D->E->F->End” is the critical chain)
33.

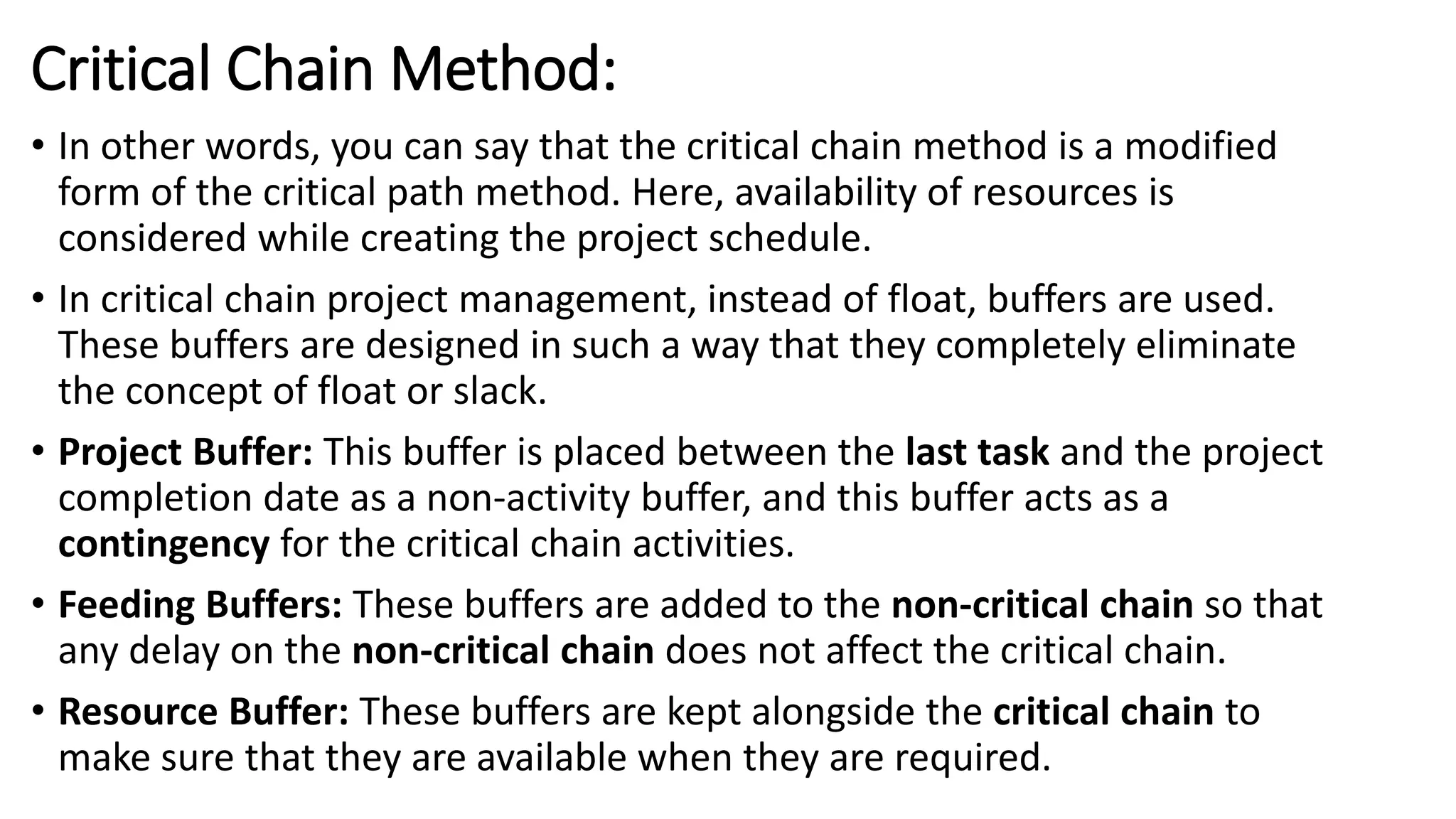

Critical Chain Method:
•In other words, you can say that the critical chain method is a modified
form of the critical path method. Here, availability of resources is
considered while creating the project schedule.
• In critical chain project management, instead of float, buffers are used.
These buffers are designed in such a way that they completely eliminate
the concept of float or slack.
• Project Buffer: This buffer is placed between the last task and the project
completion date as a non-activity buffer, and this buffer acts as a
contingency for the critical chain activities.
• Feeding Buffers: These buffers are added to the non-critical chain so that
any delay on the non-critical chain does not affect the critical chain.
• Resource Buffer: These buffers are kept alongside the critical chain to
make sure that they are available when they are required.
34.

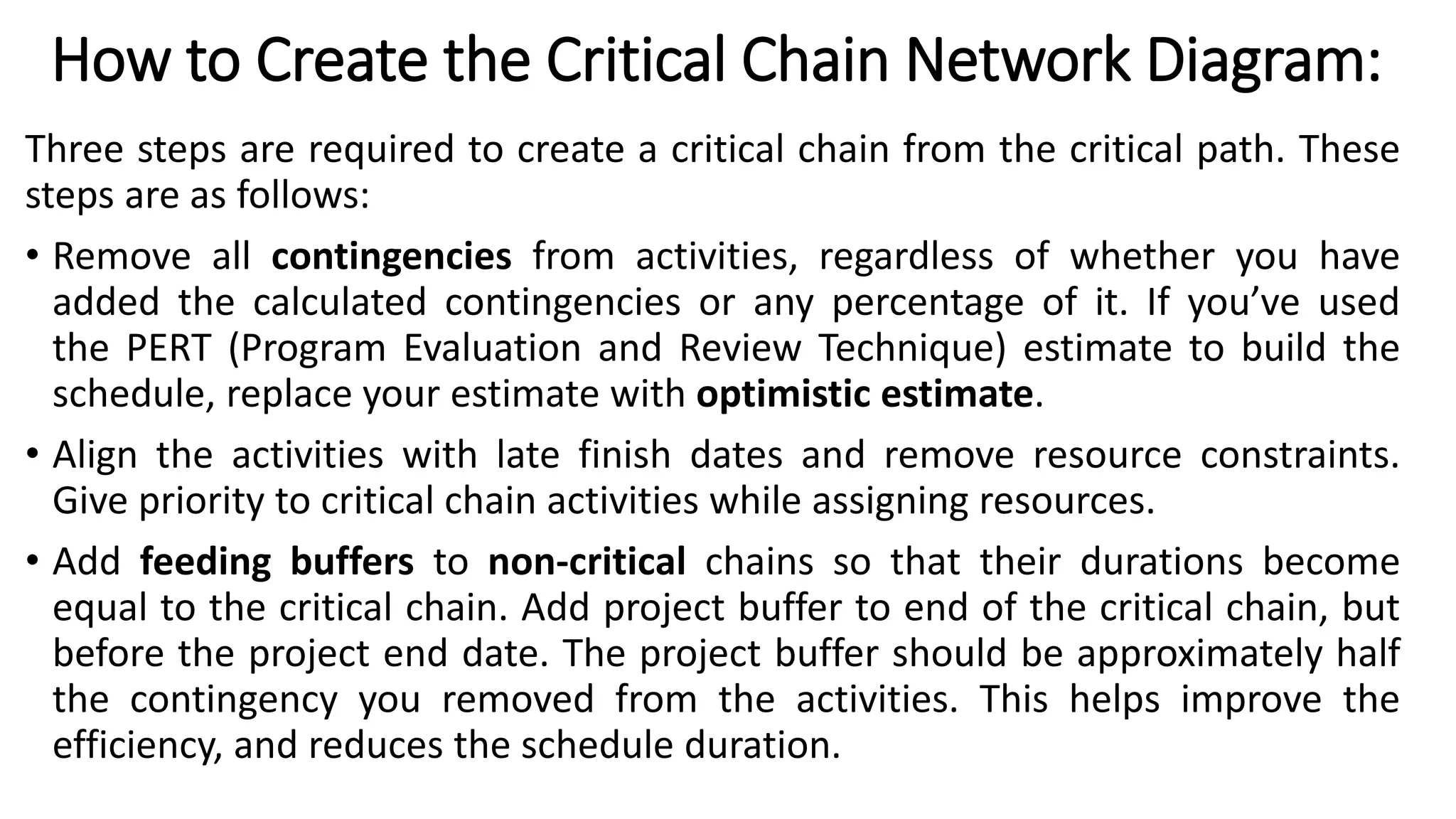

How to Createthe Critical Chain Network Diagram:
Three steps are required to create a critical chain from the critical path. These
steps are as follows:
• Remove all contingencies from activities, regardless of whether you have
added the calculated contingencies or any percentage of it. If you’ve used
the PERT (Program Evaluation and Review Technique) estimate to build the
schedule, replace your estimate with optimistic estimate.
• Align the activities with late finish dates and remove resource constraints.
Give priority to critical chain activities while assigning resources.
• Add feeding buffers to non-critical chains so that their durations become
equal to the critical chain. Add project buffer to end of the critical chain, but
before the project end date. The project buffer should be approximately half
the contingency you removed from the activities. This helps improve the
efficiency, and reduces the schedule duration.
35.

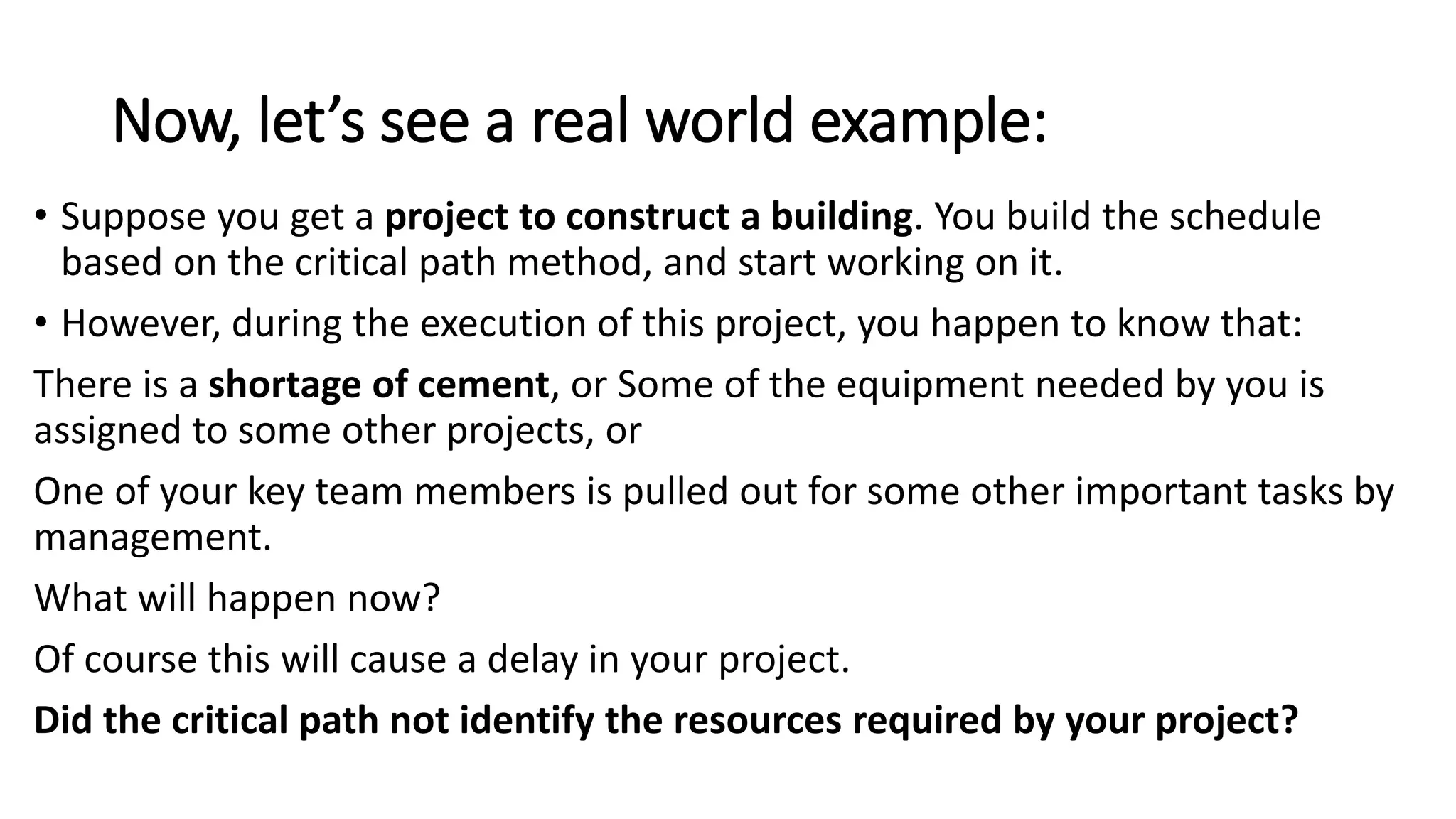

Now, let’s seea real world example:
• Suppose you get a project to construct a building. You build the schedule
based on the critical path method, and start working on it.
• However, during the execution of this project, you happen to know that:
There is a shortage of cement, or Some of the equipment needed by you is
assigned to some other projects, or
One of your key team members is pulled out for some other important tasks by
management.
What will happen now?
Of course this will cause a delay in your project.
Did the critical path not identify the resources required by your project?
36.
Now, let’s seea Real World Example:
The problem was with the resource allocation. Although the critical path had
identified the resources, it did not account for the limited availability of
resources into the schedule. The project schedule was developed optimistically,
assuming that all resources would be available whenever they were needed.
Unfortunately this could not happen in this case, putting the project in trouble.
Therefore, to solve these issues, you made some modifications to the critical
path, considering limited resource availability. Now this critical path has been
converted to the critical chain, and it is more realistic.
37.
Key Features ofCritical Chain Management:
• It is a deterministic model
• It avoids mismanagement of slack or float
• It optimizes the utilization of resources
• The project based on the critical chain method completes 10% to 30%
faster than that based on the critical path method
• It is a more practical approach
• It encourages team members to perform efficiently, and
• It improves the productivity
38.
Summary
• Critical chainmethod is an upgraded version of the critical path method,
which is a more practical approach to developing the project schedule.
• In critical chain method, the availability of resources is taken into
consideration while drawing the network diagram.
• In this method, you use buffers instead of float, which reduce the
mismanagement of float, which is seen in the critical path method.
There is no doubt that the critical chain method is one of the most important
developments in project management recently. This method answers many
shortcomings of the critical path method, provides a realistic schedule,
encourages team members to perform efficiently, and improves productivity.
