CHAPTER 6
PROJECT MANAGEMENT
(PM)

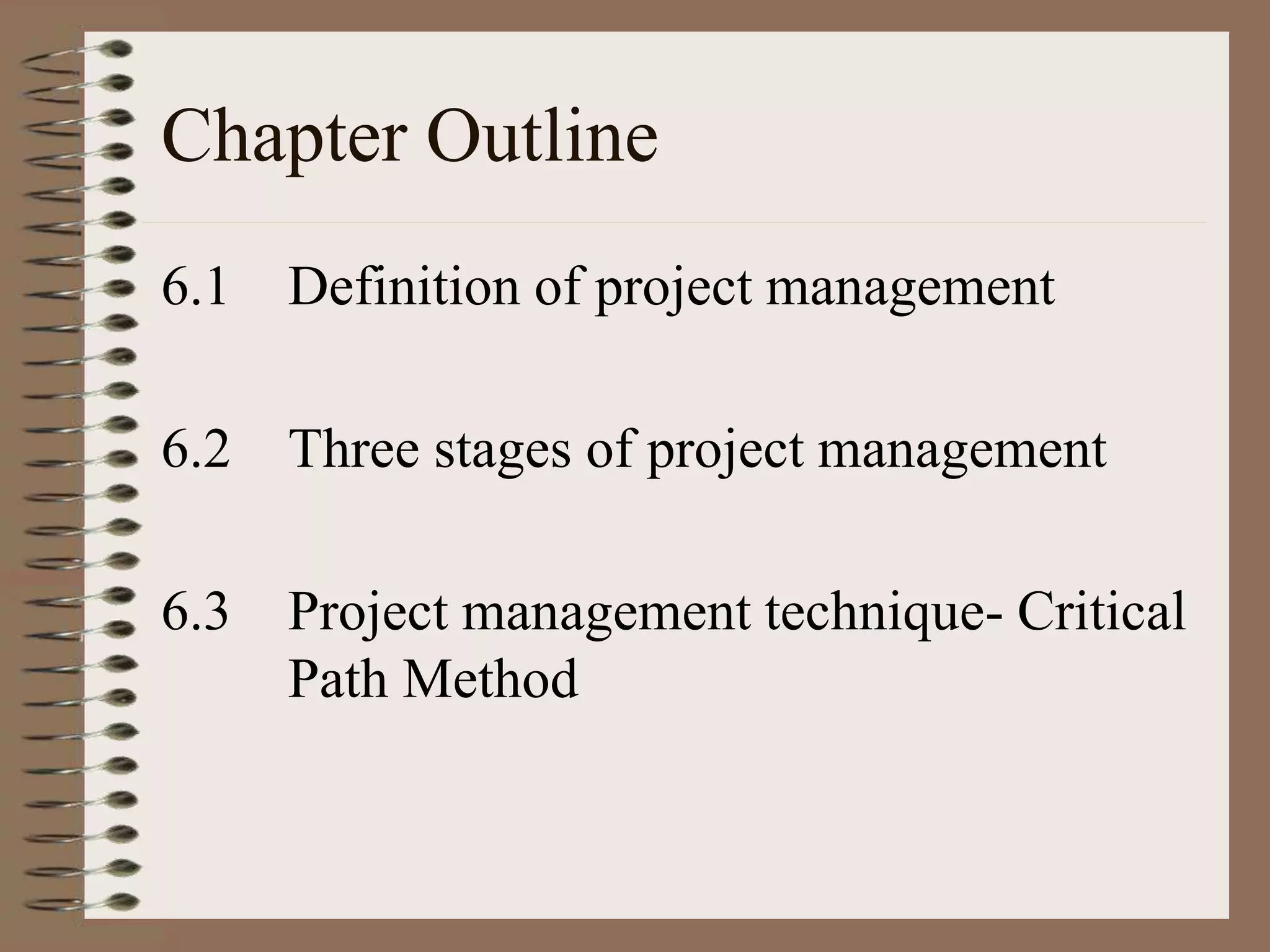

Chapter Outline
6.1 Definition of project management
6.2 Three stages of project management
6.3 Project management technique- Critical
Path Method

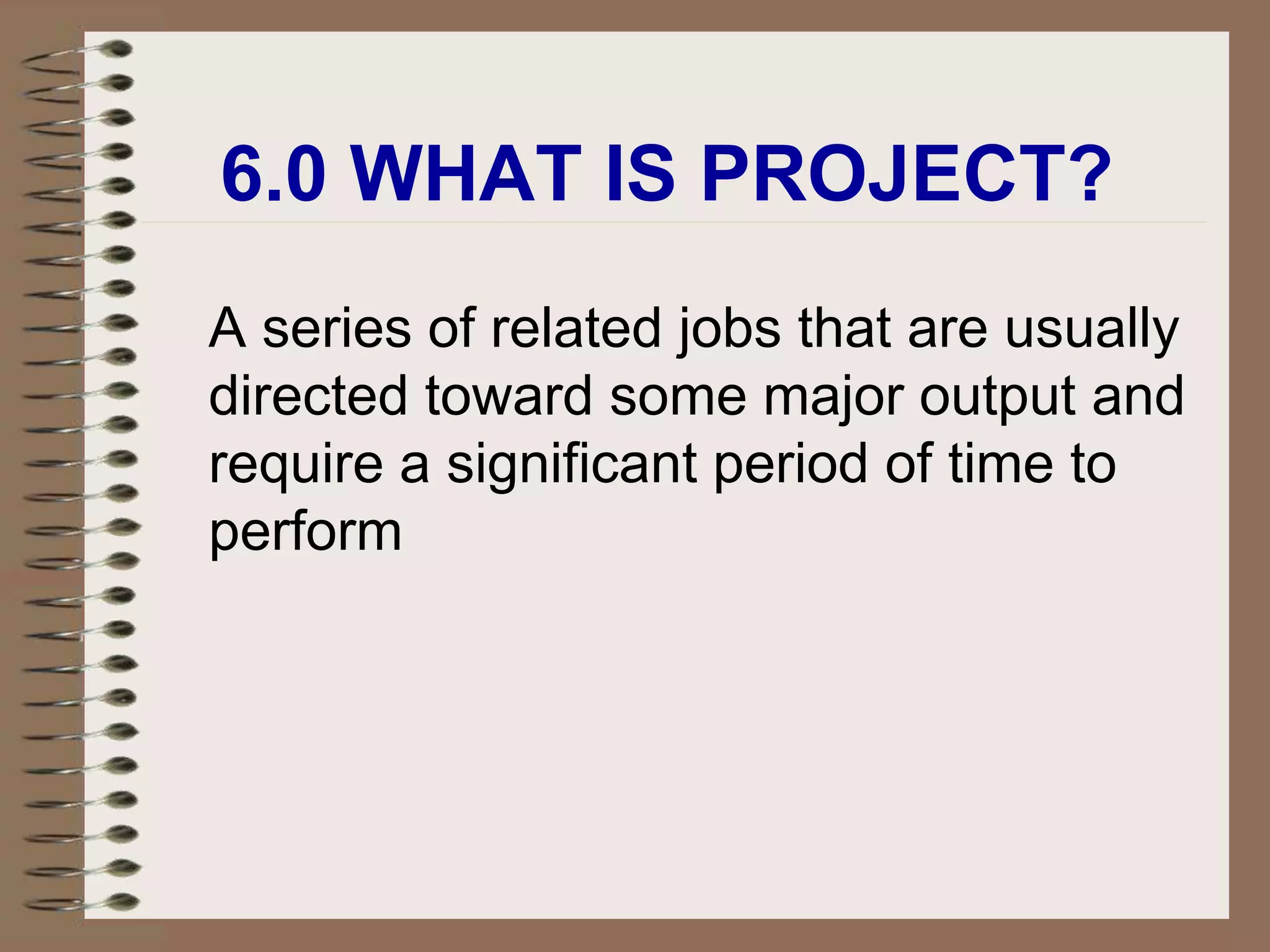

6.0 WHAT IS PROJECT?
A series of related jobs that are usually
directed toward some major output and
require a significant period of time to
perform
The planning, directing and controlling
resources (i.e. people, equipment,
material) to meet the technical, cost
and time constraints of the project.

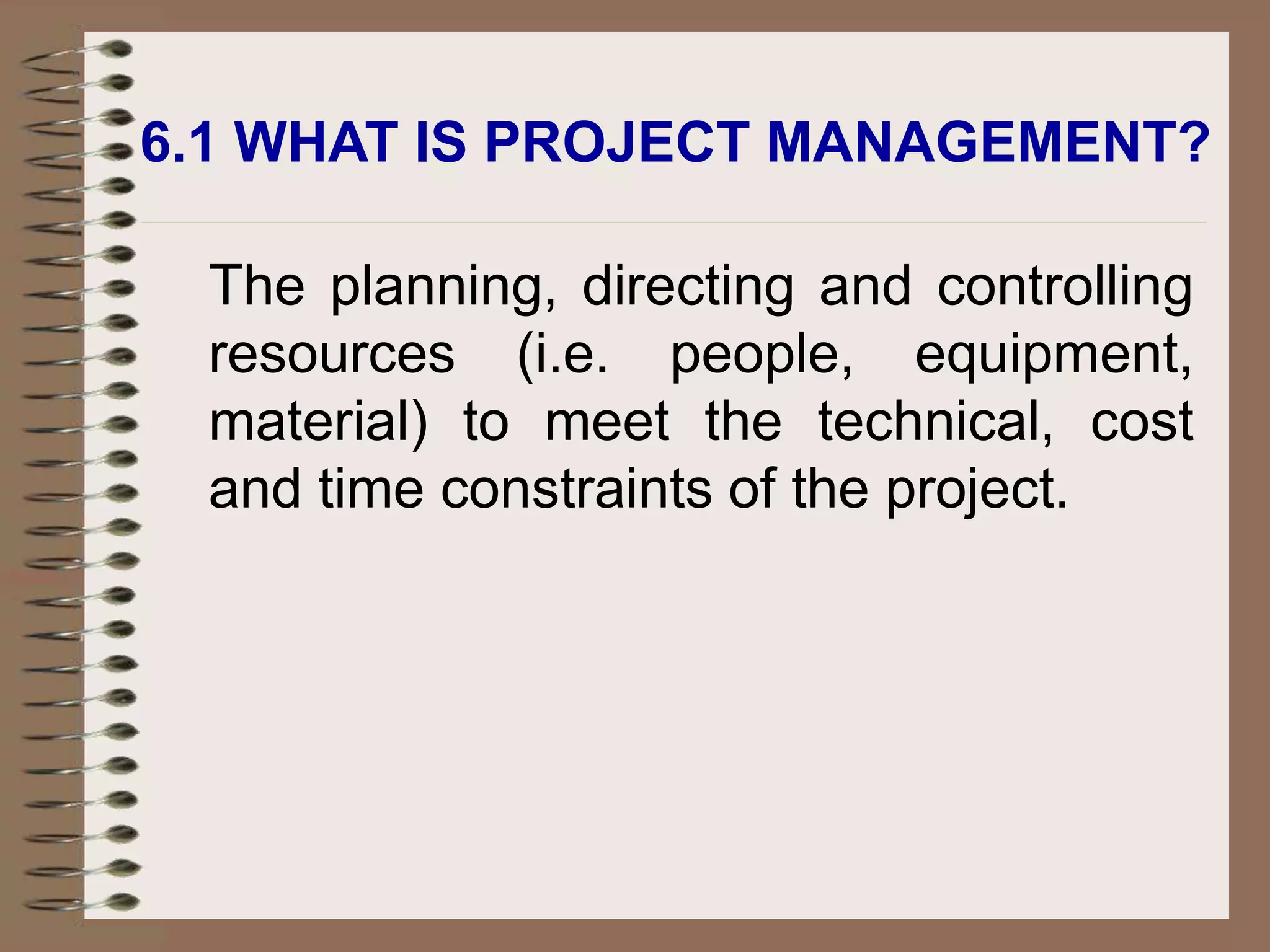

6.1 WHAT IS PROJECT MANAGEMENT?

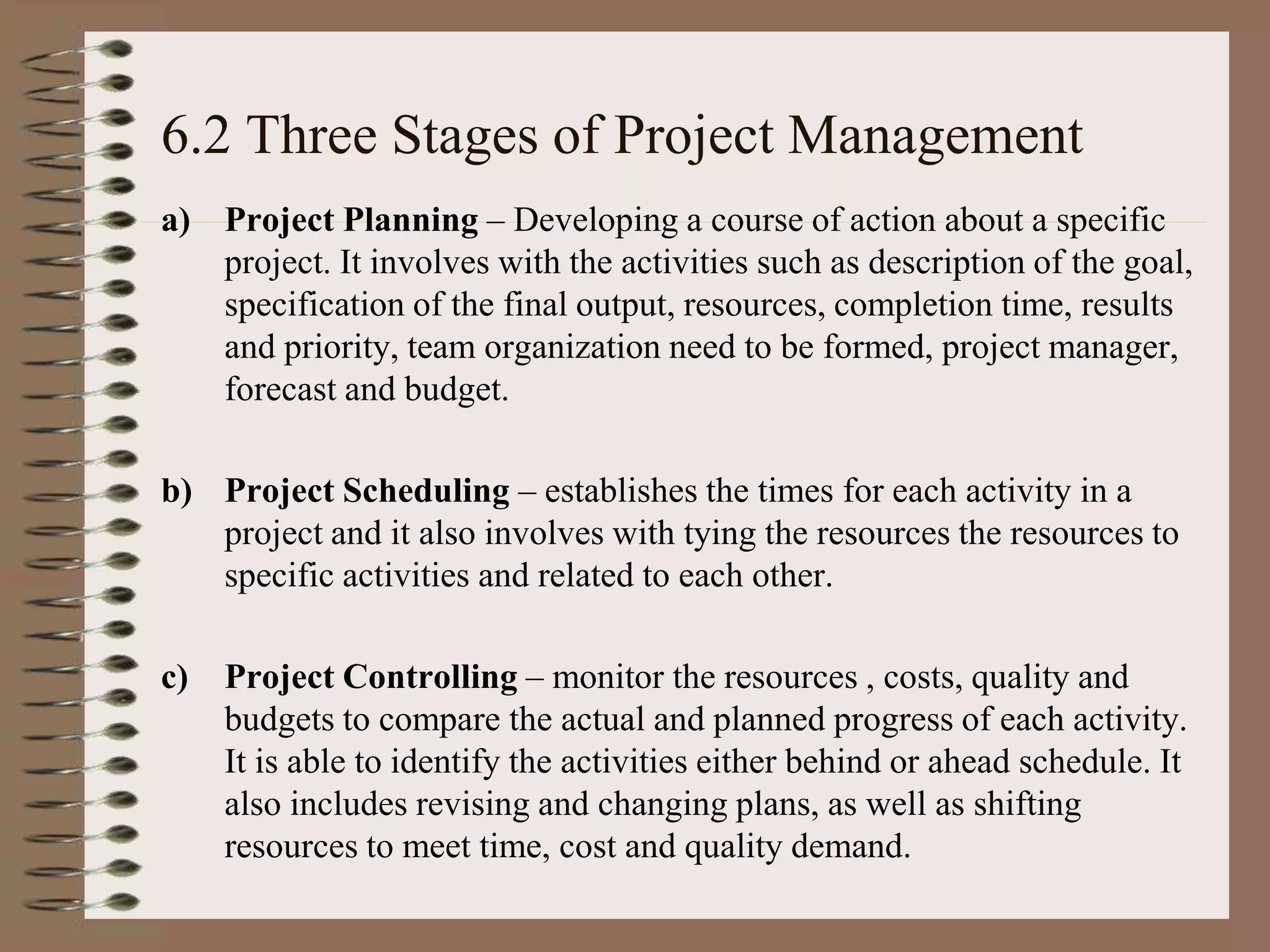

6.2 Three Stages of Project Management
a) Project Planning – Developing a course of action about a specific
project. It involves with the activities such as description of the goal,
specification of the final output, resources, completion time, results
and priority, team organization need to be formed, project manager,
forecast and budget.
b) Project Scheduling – establishes the times for each activity in a
project and it also involves with tying the resources the resources to
specific activities and related to each other.
c) Project Controlling – monitor the resources , costs, quality and
budgets to compare the actual and planned progress of each activity.
It is able to identify the activities either behind or ahead schedule. It
also includes revising and changing plans, as well as shifting
resources to meet time, cost and quality demand.

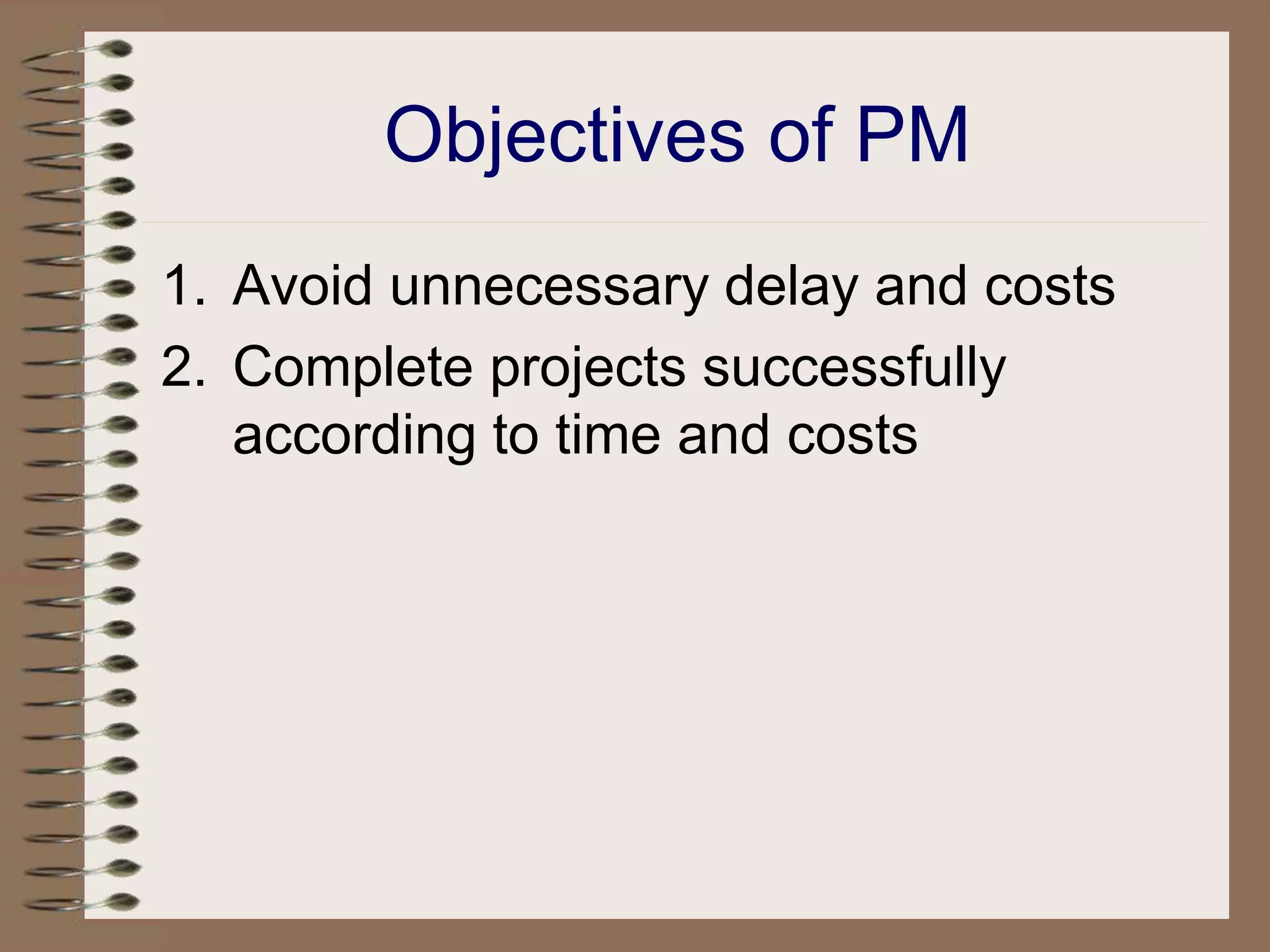

Objectives of PM
1. Avoid unnecessary delay and costs
2. Complete projects successfully
according to time and costs

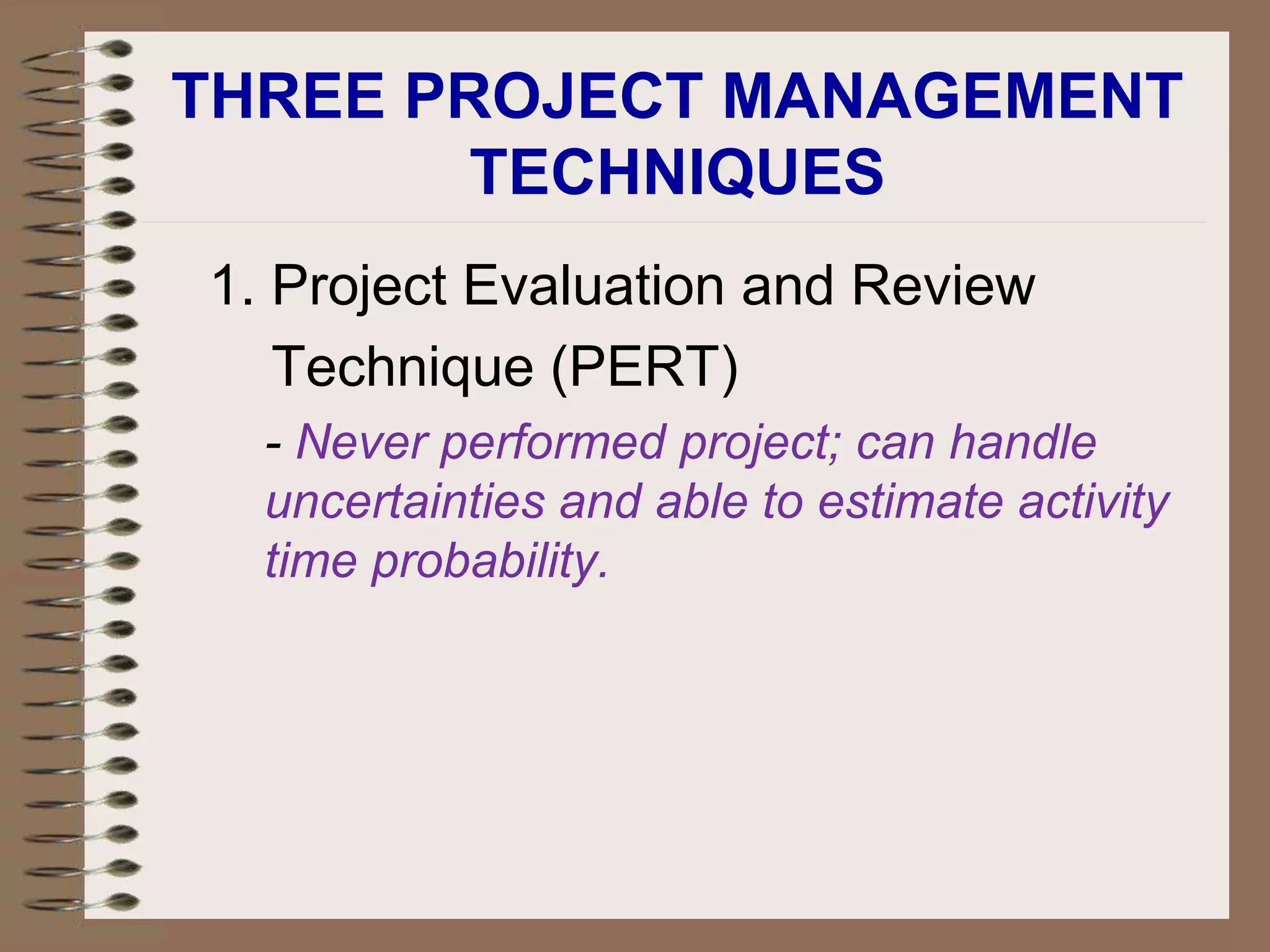

THREE PROJECT MANAGEMENT
TECHNIQUES
1. Project Evaluation and Review
Technique (PERT)
- Never performed project; can handle
uncertainties and able to estimate activity
time probability.

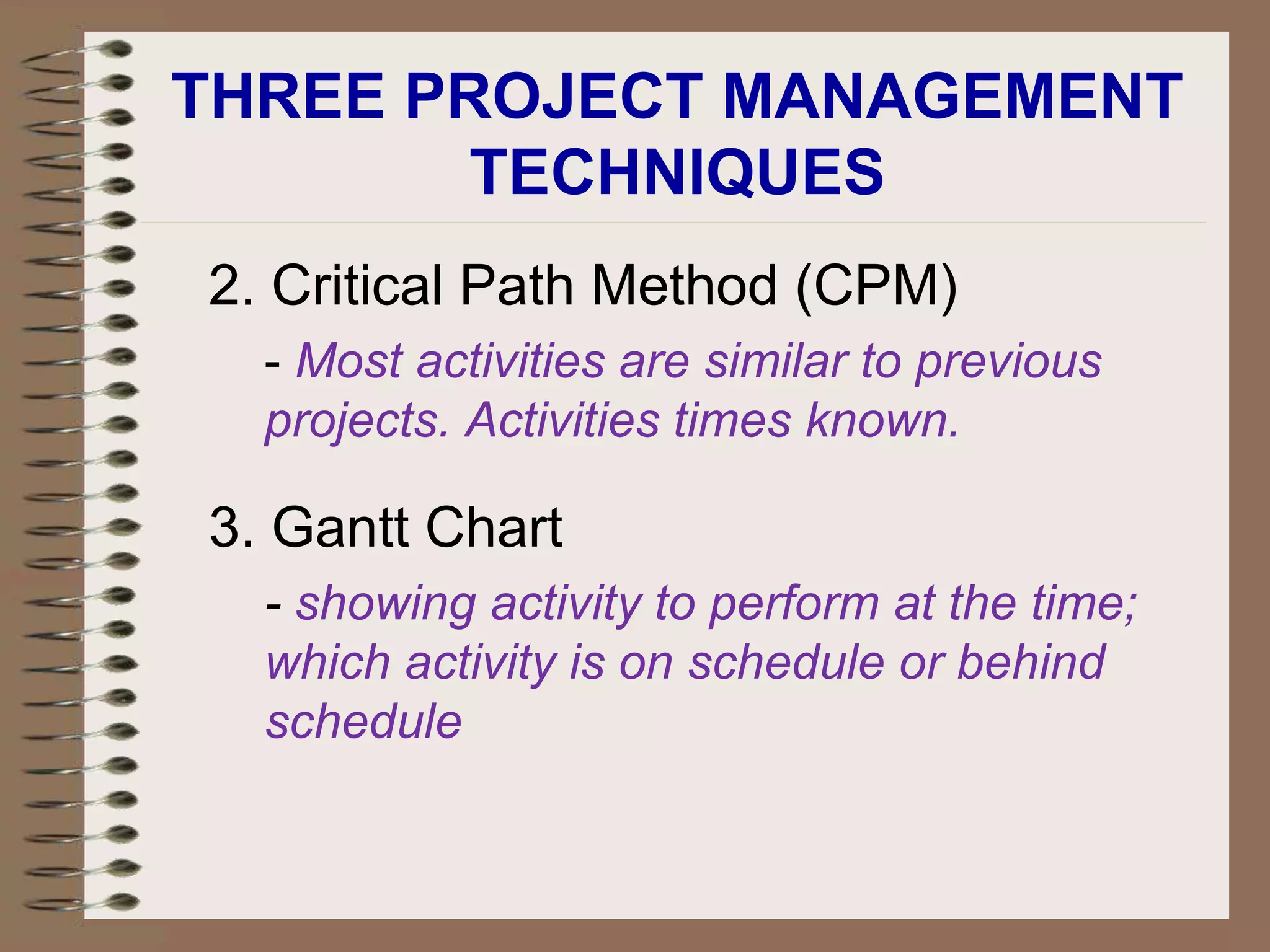

THREE PROJECT MANAGEMENT
TECHNIQUES
2. Critical Path Method (CPM)
- Most activities are similar to previous
projects. Activities times known.
3. Gantt Chart
- showing activity to perform at the time;
which activity is on schedule or behind
schedule
1. When will the entire project be
completed?
2. What are the critical activities or tasks in
the project?
3. Which are the noncritical activities?
4. What is the probability the project will be
completed by a specific date?

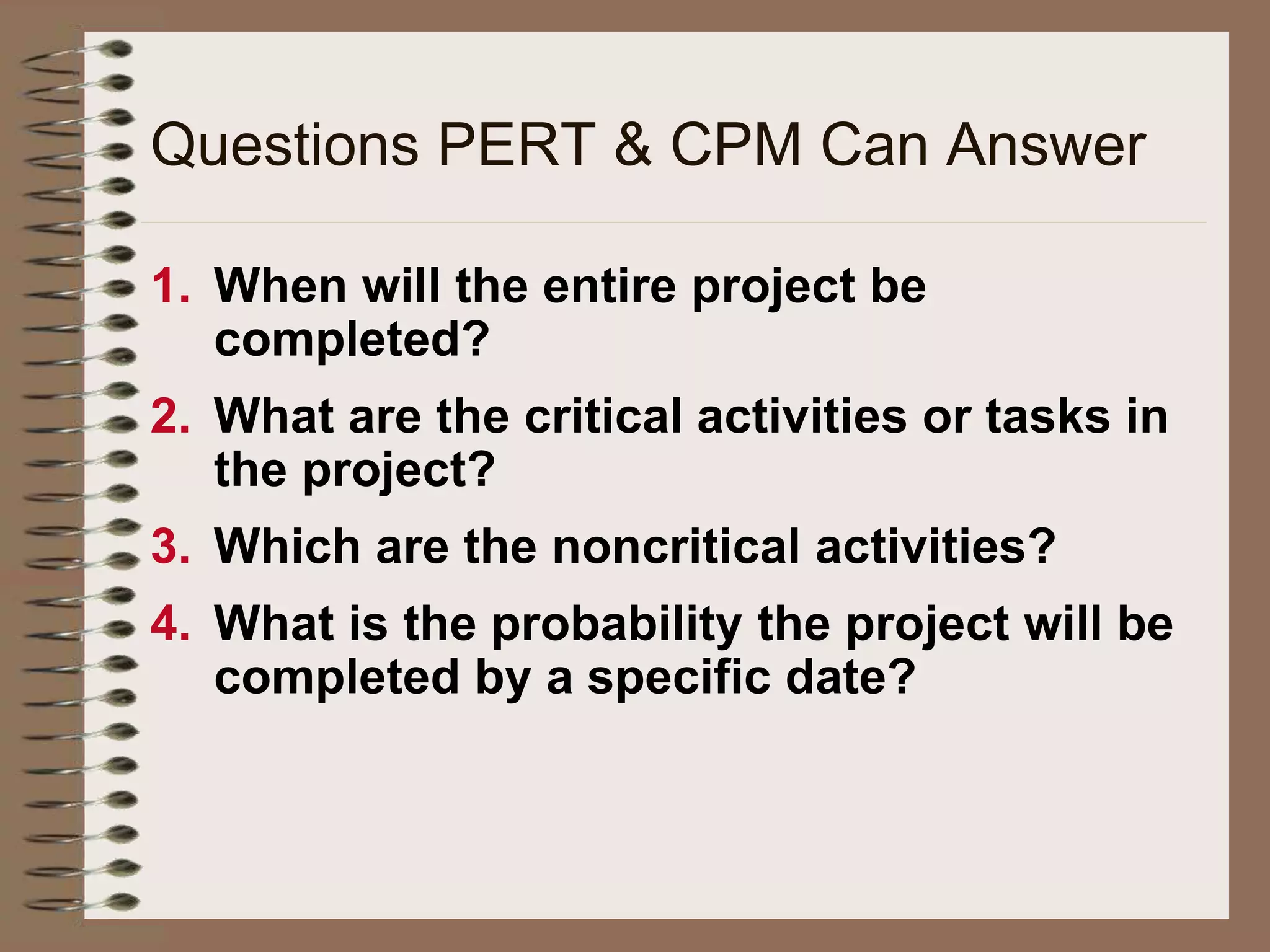

Questions PERT & CPM Can Answer

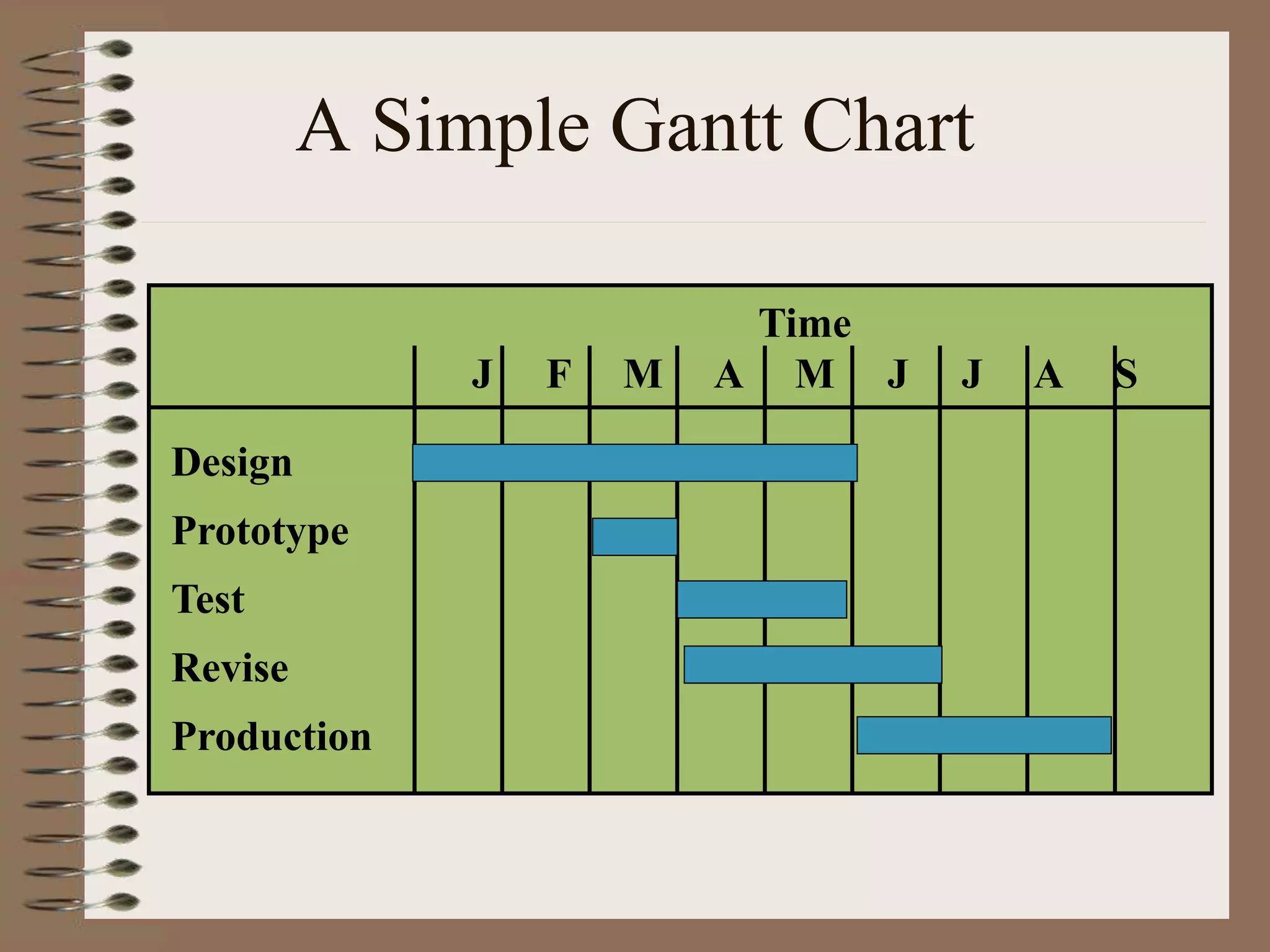

A Simple Gantt Chart
Time
J F M A M J J A S
Design
Prototype
Test
Revise
Production

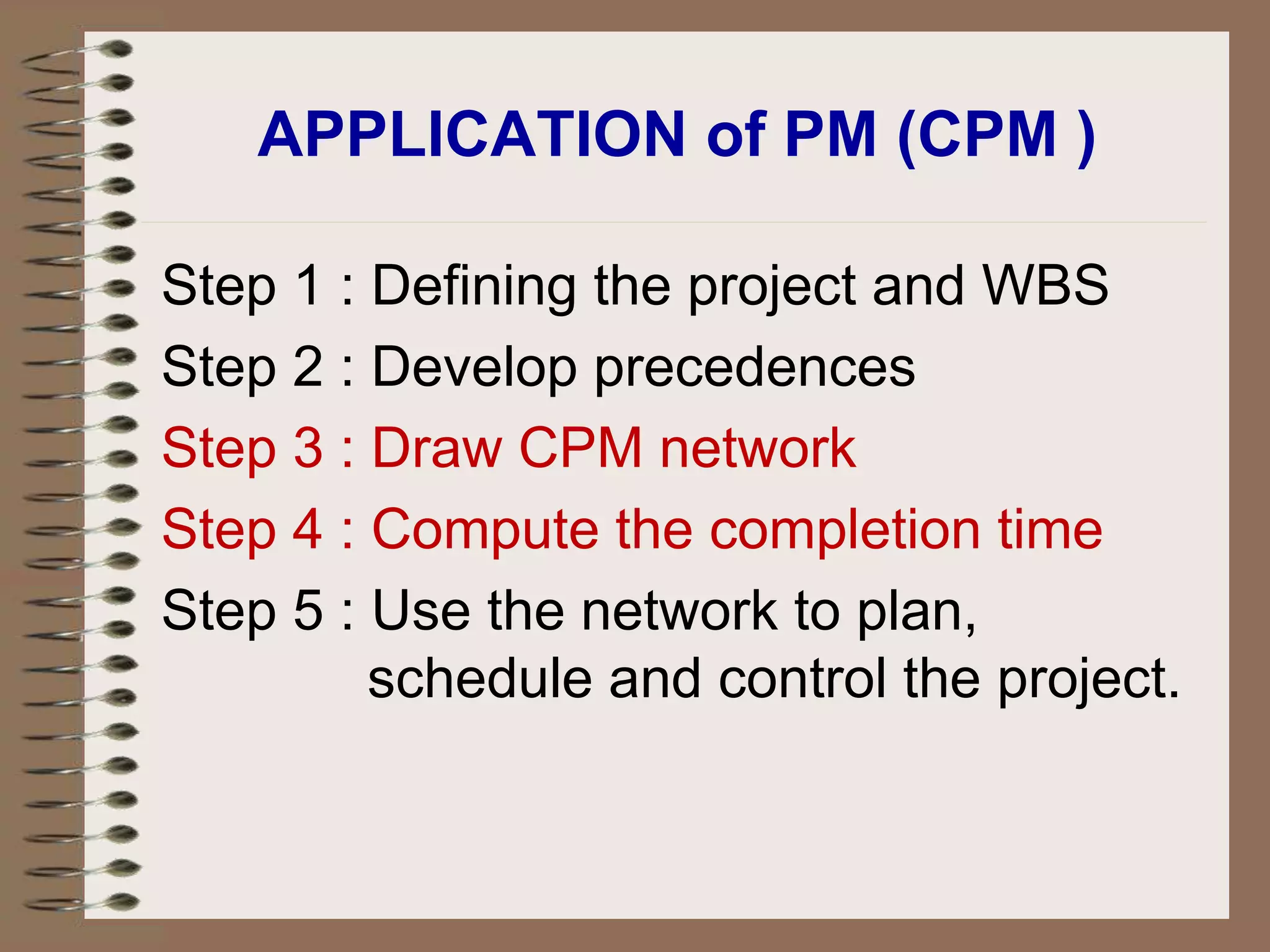

APPLICATION of PM (CPM )
Step 1 : Defining the project and WBS
Step 2 : Develop precedences
Step 3 : Draw CPM network
Step 4 : Compute the completion time
Step 5 : Use the network to plan,
schedule and control the project.

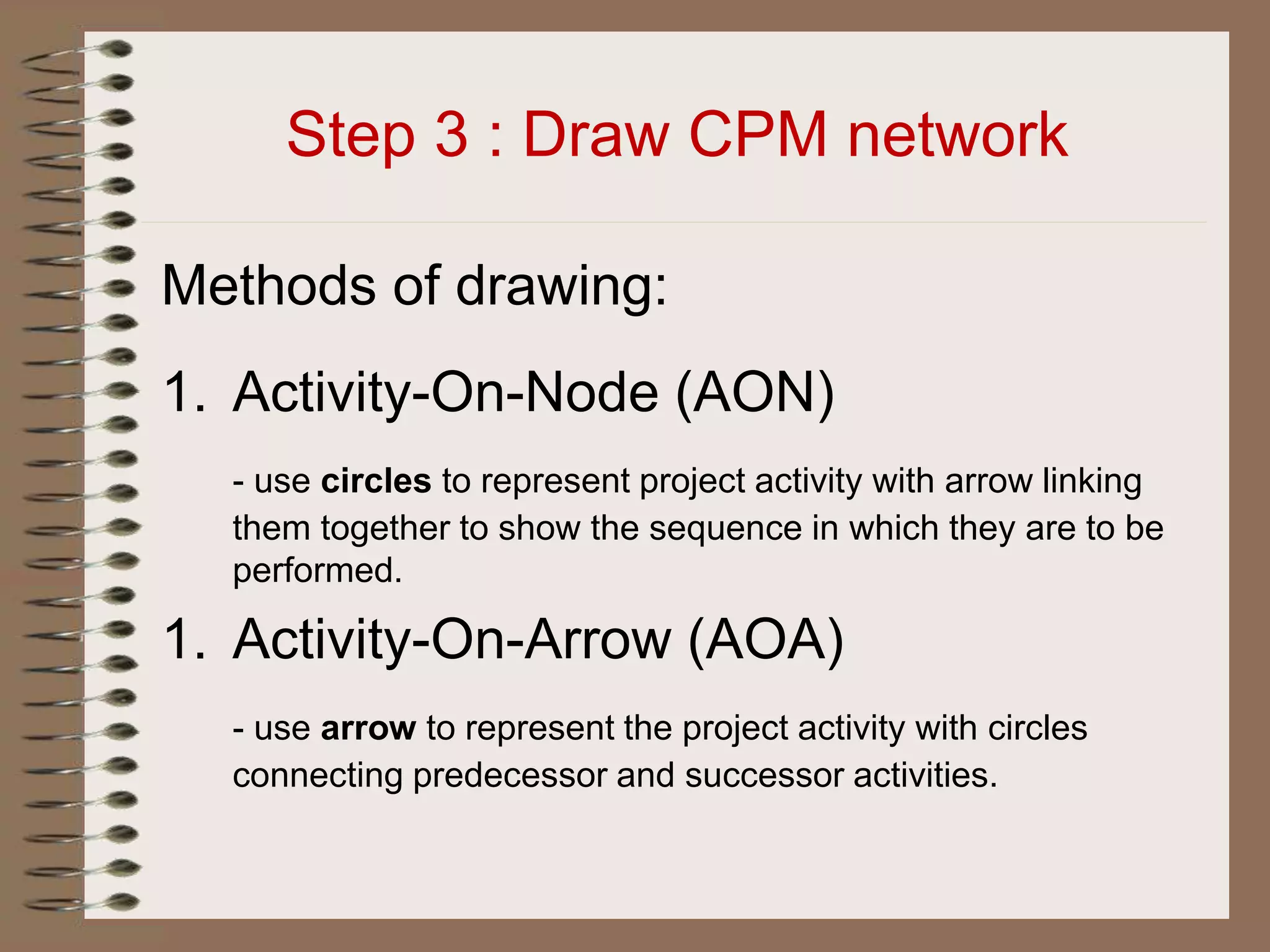

Step 3 : Draw CPM network
Methods of drawing:
1. Activity-On-Node (AON)
- use circles to represent project activity with arrow linking
them together to show the sequence in which they are to be
performed.
1. Activity-On-Arrow (AOA)
- use arrow to represent the project activity with circles
connecting predecessor and successor activities.
A Comparison of AON and AOA
Network Conventions
Activity on Activity Activity on
Node (AON) Meaning Arrow (AOA)
1 2 3 4
A comes before
B, which comes
before C.
(a) A B C
BA C
3 4
1
2
A and B must both
be completed before
C can start.
(b)
A
C
C
B
A
B
1 2
3
4
B and C cannot
begin until A is
completed.
(c)
B
A
C
A
B
C

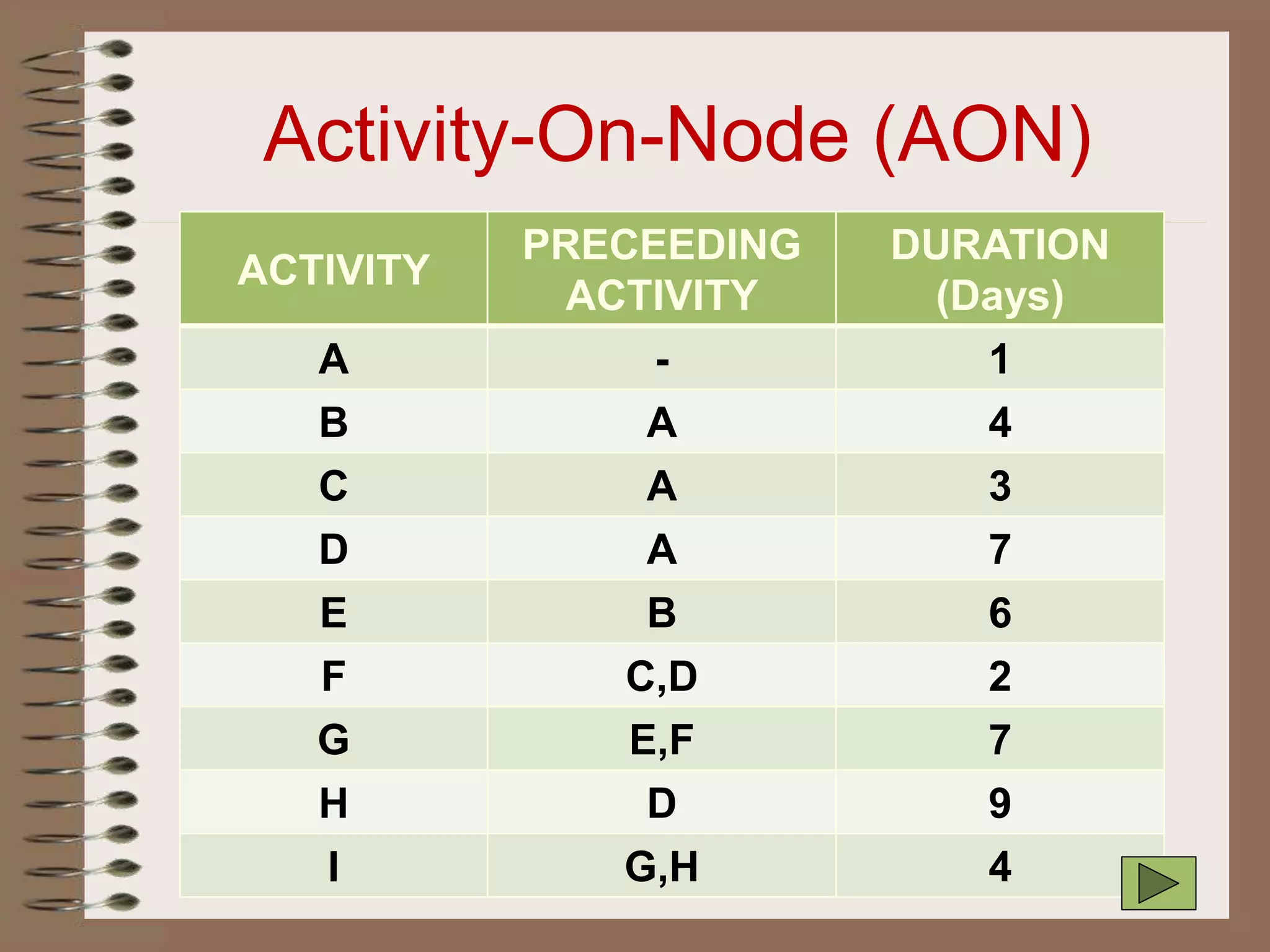

Activity-On-Node (AON)
ACTIVITY
PRECEEDING
ACTIVITY
DURATION
(Days)
A - 1
B A 4
C A 3
D A 7
E B 6
F C,D 2
G E,F 7
H D 9
I G,H 4

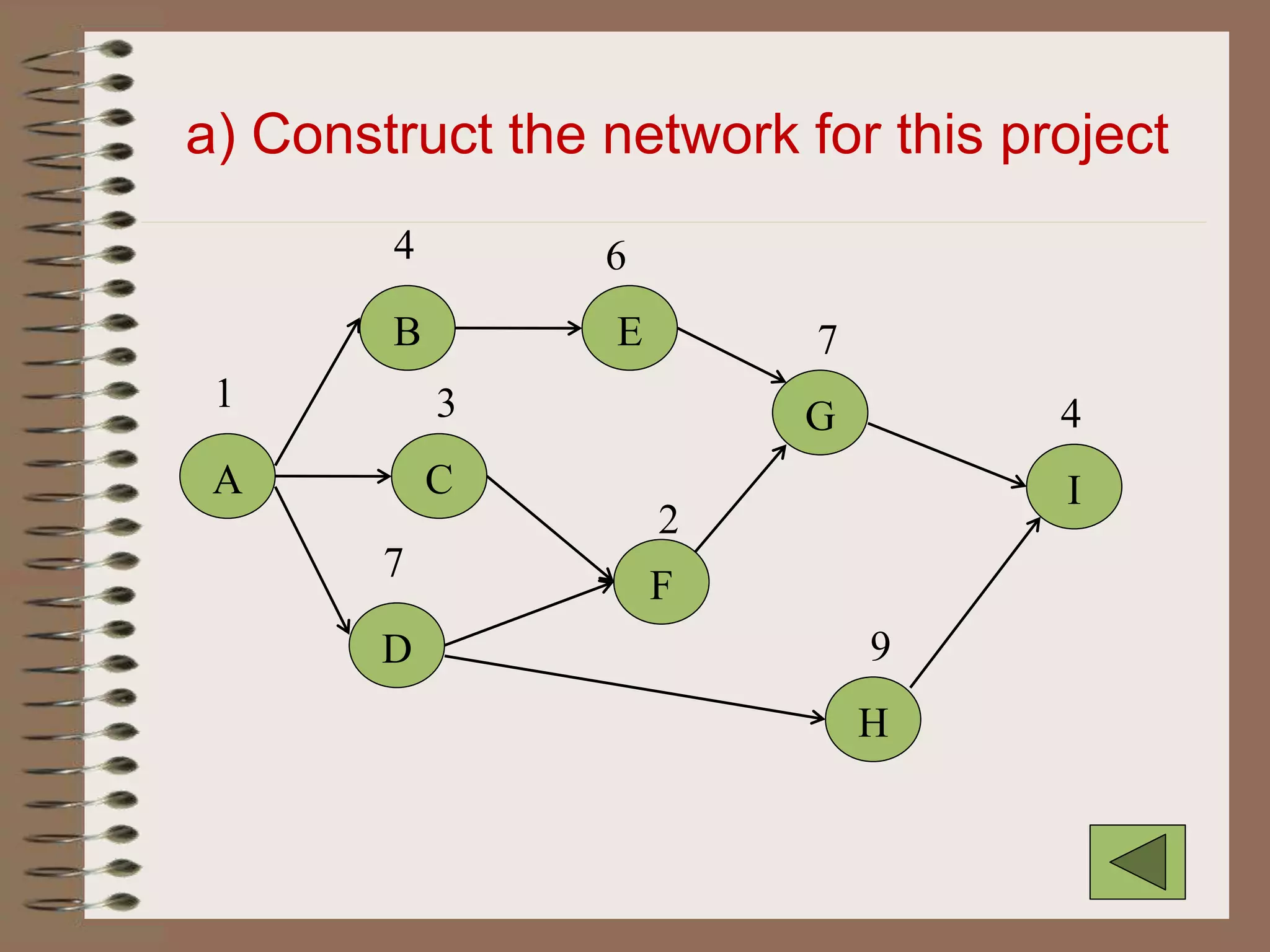

a) Construct the network for this project
A
B
1
4
C
D
3
F
4
9
7E
7
6
2
G
H
I

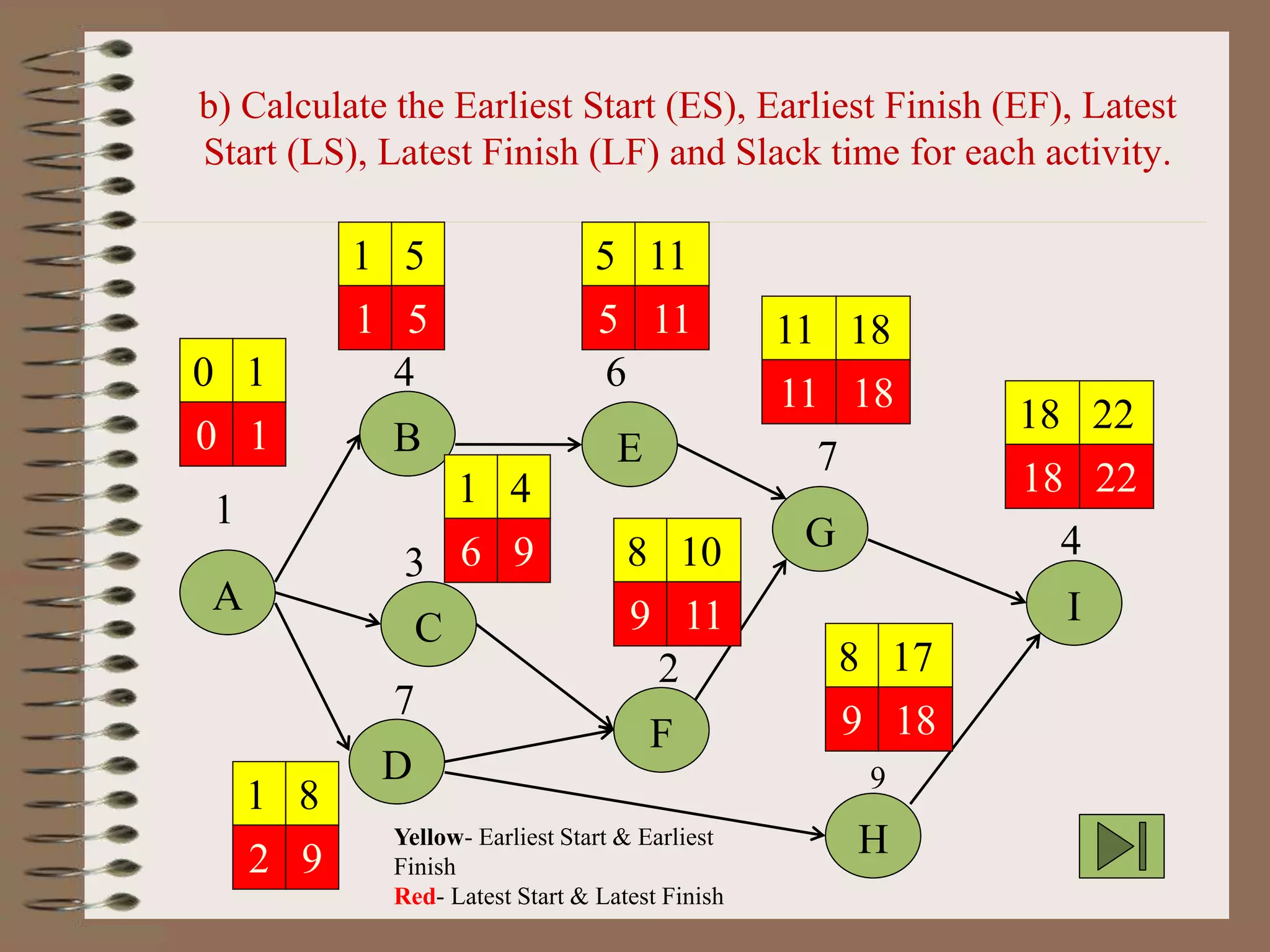

b) Calculate the Earliest Start (ES), Earliest Finish (EF), Latest
Start (LS), Latest Finish (LF) and Slack time for each activity.
A
B
1
C
D
3
F
4
9
7E
7
6
2
G
H
I
0
0
1
1
1
1
5
5
5
5
11
11 11
11
18
18
1
6
4
9
1
2
8
9
8
9
10
11
8
9
17
18
18
18
22
22
4
Yellow- Earliest Start & Earliest
Finish
Red- Latest Start & Latest Finish

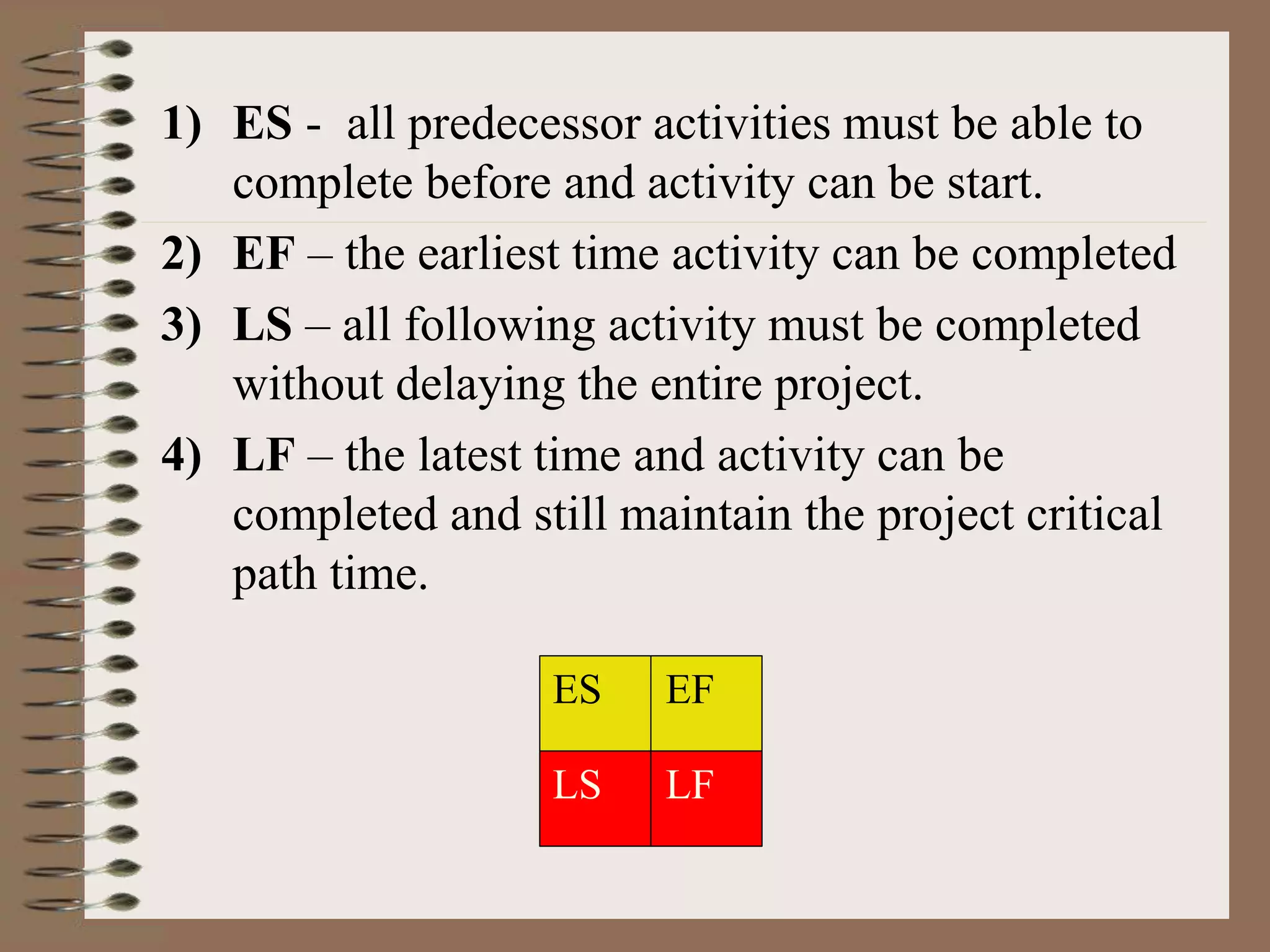

1) ES - all predecessor activities must be able to
complete before and activity can be start.
2) EF – the earliest time activity can be completed
3) LS – all following activity must be completed
without delaying the entire project.
4) LF – the latest time and activity can be
completed and still maintain the project critical
path time.
ES EF
LS LF
Slack Time - activity that can be delayed without
affecting completion time activities
that is not the critical path
C
1
6
4
9
Slack = LF – EF @ LS - ES
Slack = 9 – 4 = 5 days
D
1
2
8
9 Slack = 9 – 8 = 1 day
Slack (H) = 18 – 17 = 1 day
Slack (F) = 11 – 10 = 1 day

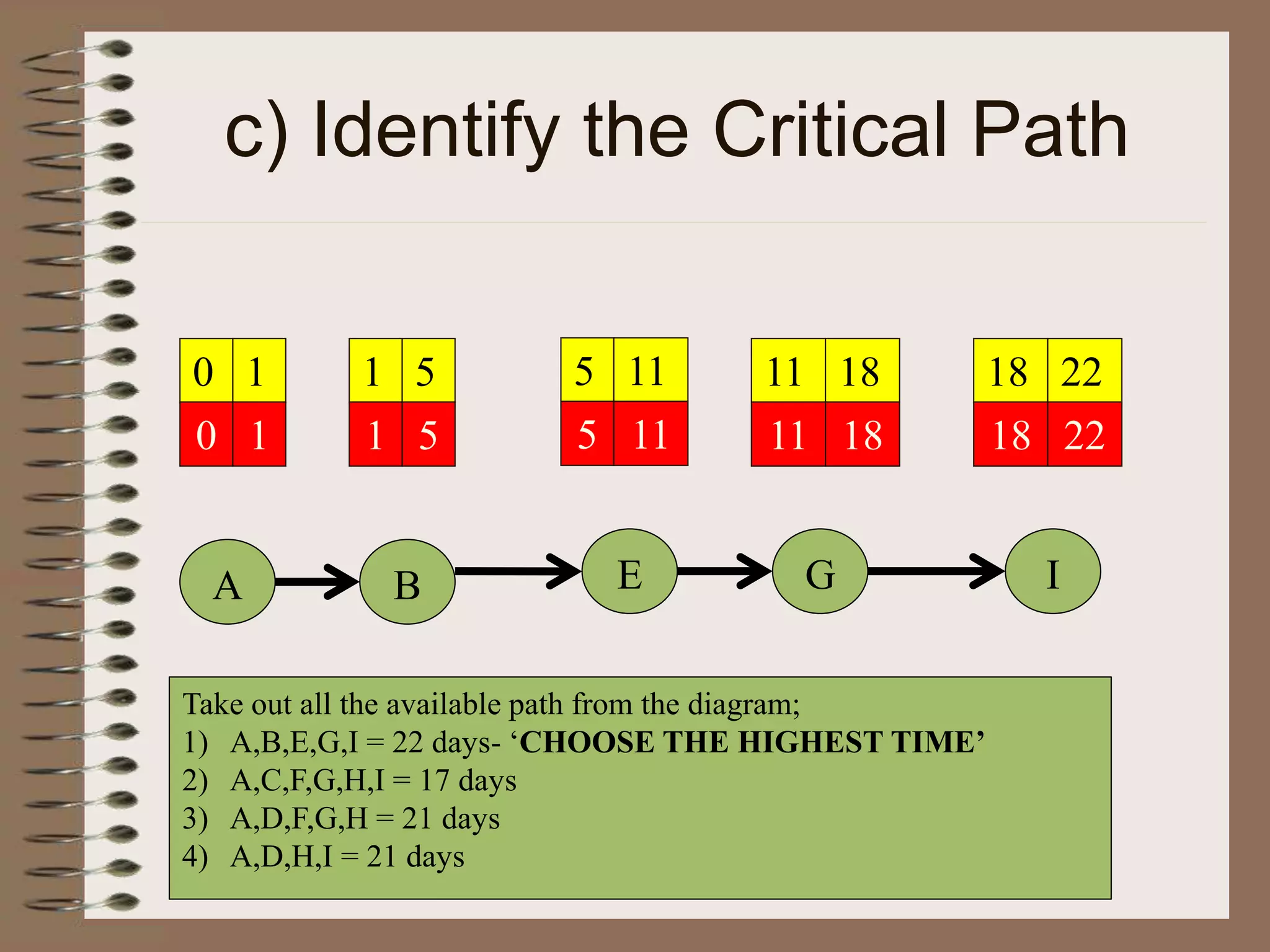

c) Identify the Critical Path
A B E G I
0
0
1
1
1
1
5
5
5
5
11
11
11
11
18
18
18
18
22
22
Take out all the available path from the diagram;
1) A,B,E,G,I = 22 days- ‘CHOOSE THE HIGHEST TIME’
2) A,C,F,G,H,I = 17 days
3) A,D,F,G,H = 21 days
4) A,D,H,I = 21 days

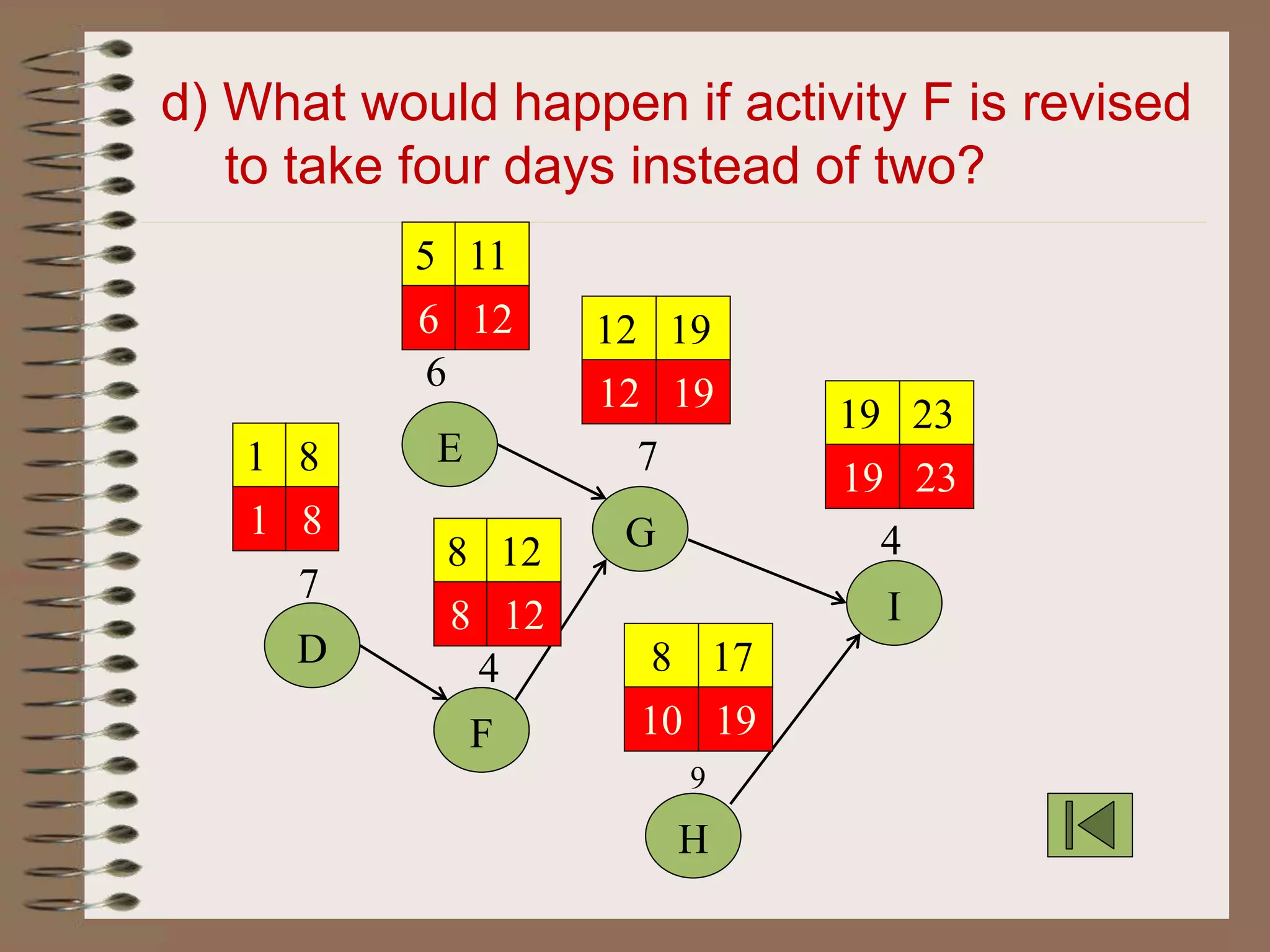

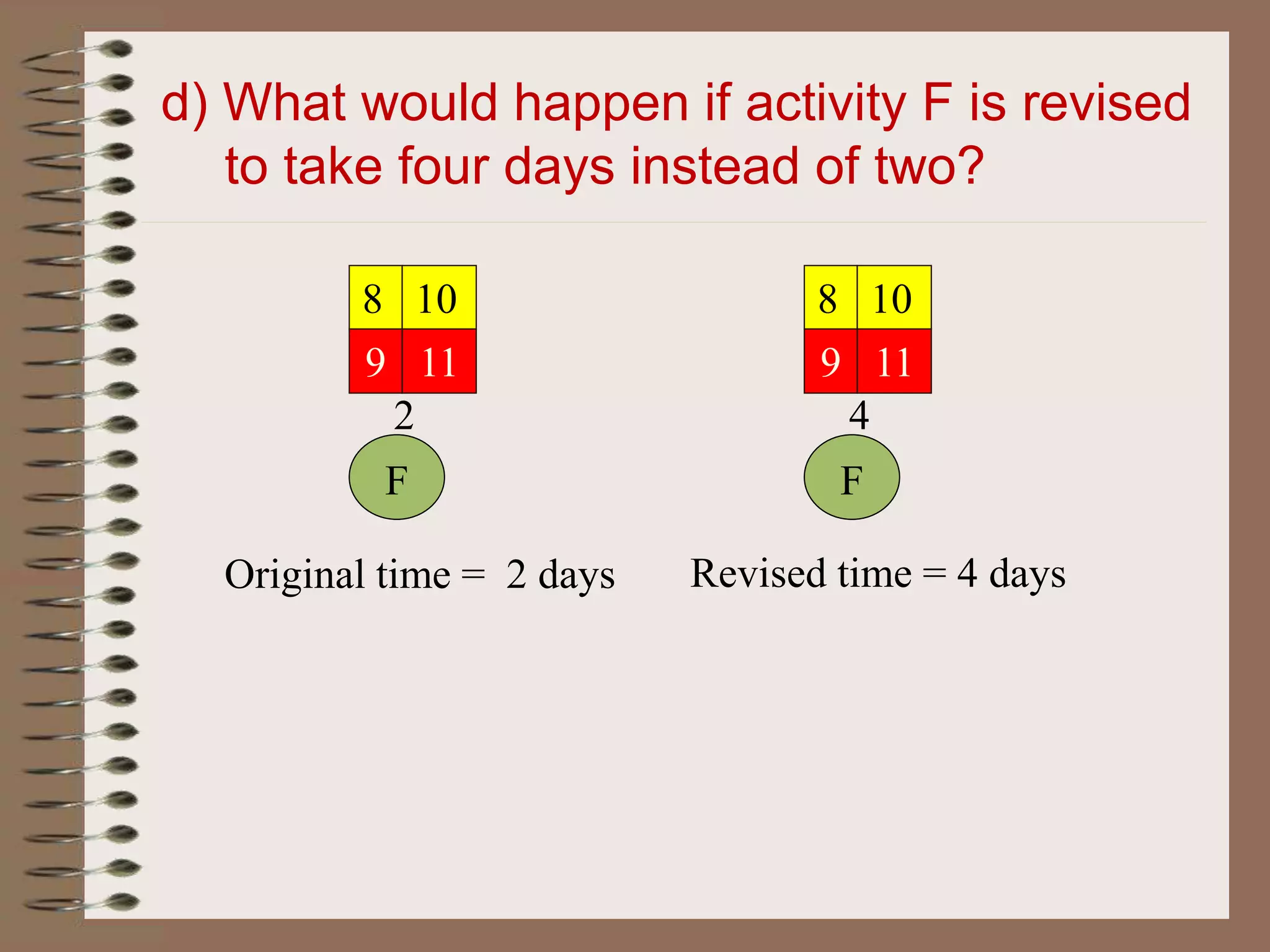

d) What would happen if activity F is revised
to take four days instead of two?
F
2
8
9
10
11
F
4
8
9
10
11
Revised time = 4 daysOriginal time = 2 days
d) What would happen if activity F is revised
to take four days instead of two?
F
4
9
7E
6
4
G
H
I
5
6
11
12 12
12
19
19
8
8
12
12
8
10
17
19
19
19
23
23
D
1
1
8
8
7

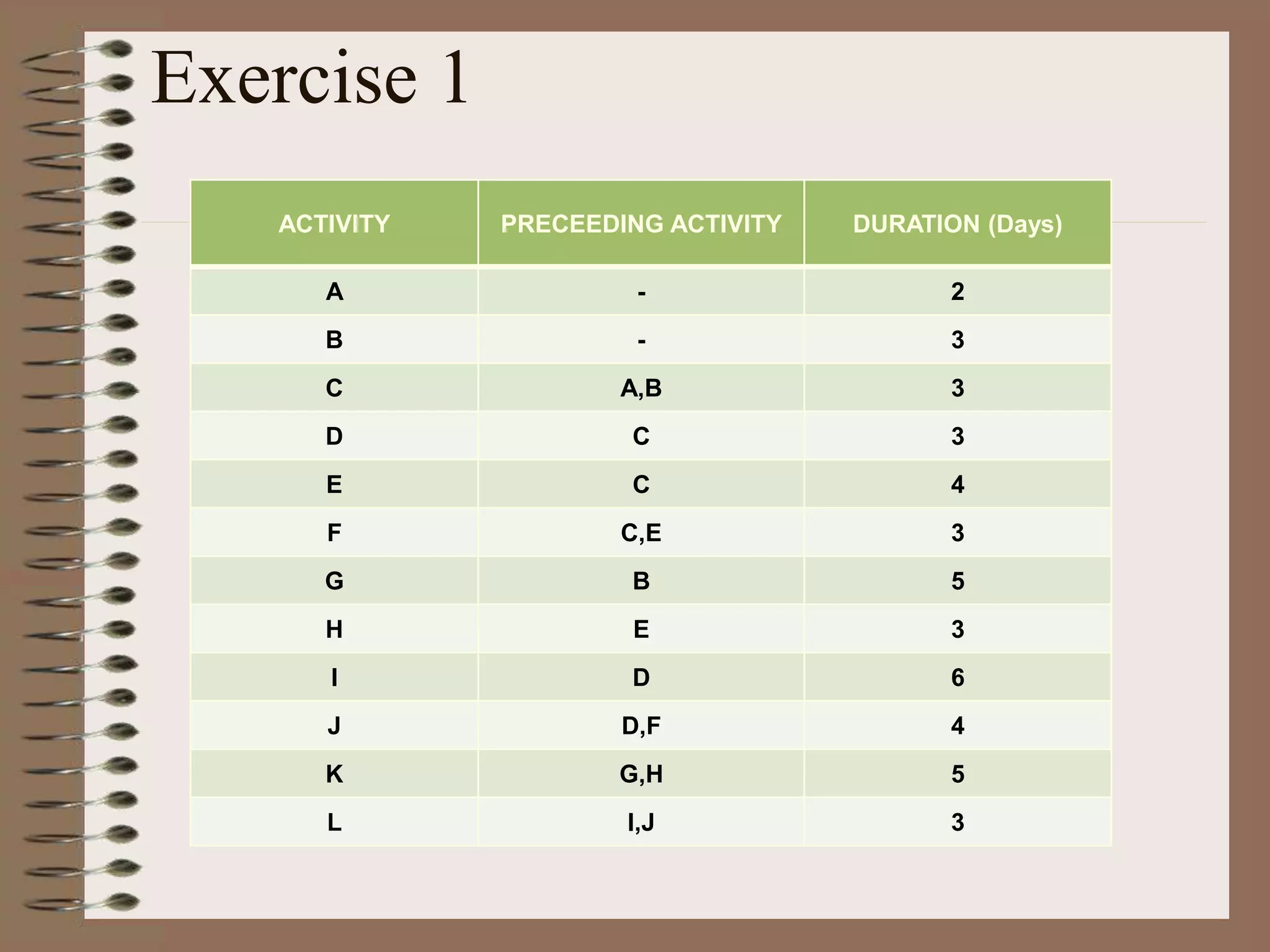

Exercise 1
ACTIVITY PRECEEDING ACTIVITY DURATION (Days)
A - 2
B - 3
C A,B 3
D C 3
E C 4
F C,E 3
G B 5
H E 3
I D 6
J D,F 4
K G,H 5
L I,J 3

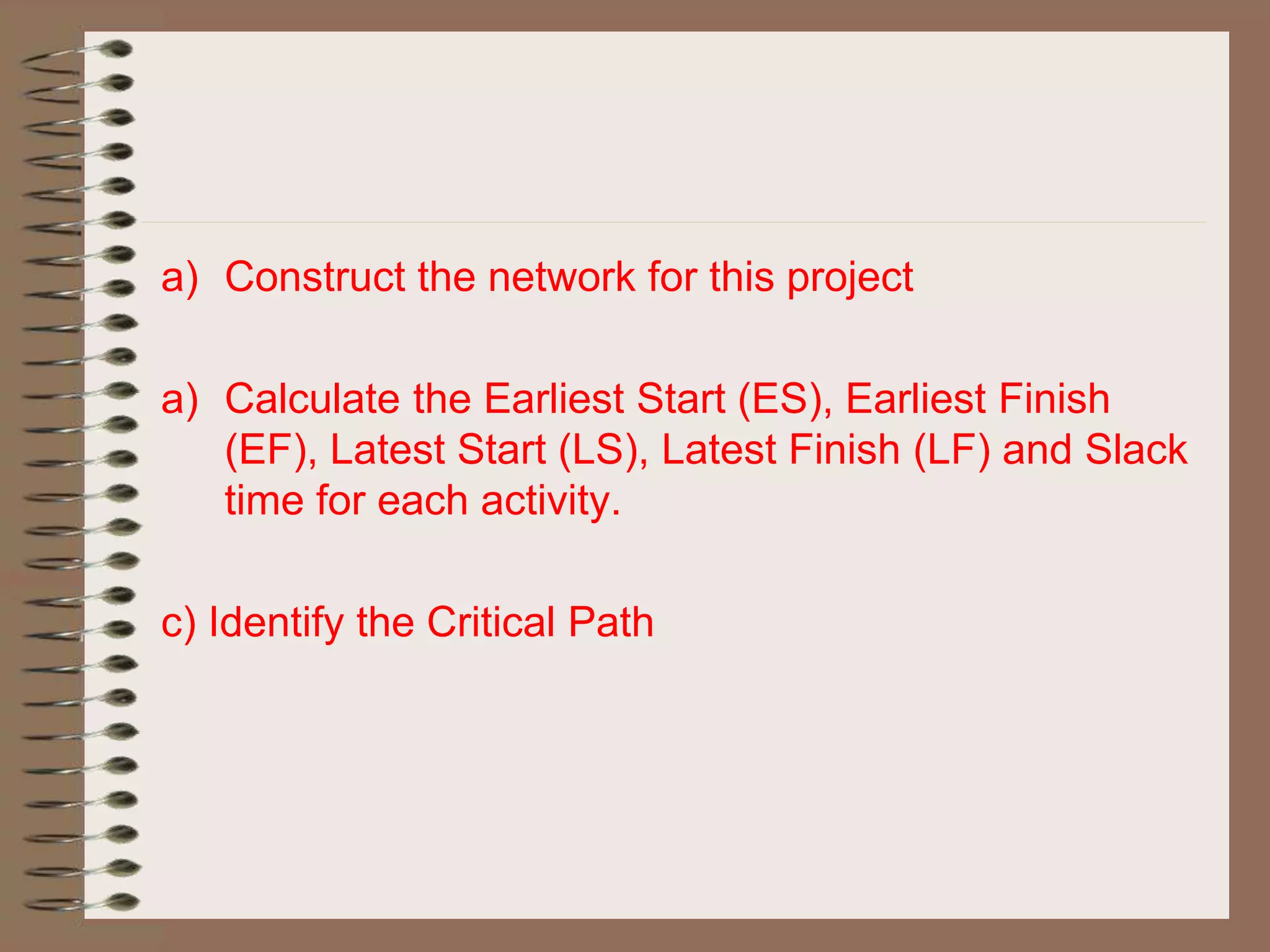

a) Construct the network for this project
a) Calculate the Earliest Start (ES), Earliest Finish
(EF), Latest Start (LS), Latest Finish (LF) and Slack
time for each activity.
c) Identify the Critical Path
Activity-On-Arrow (AOA)
ACTIVITY
PRECEEDING
ACTIVITY
DURATION

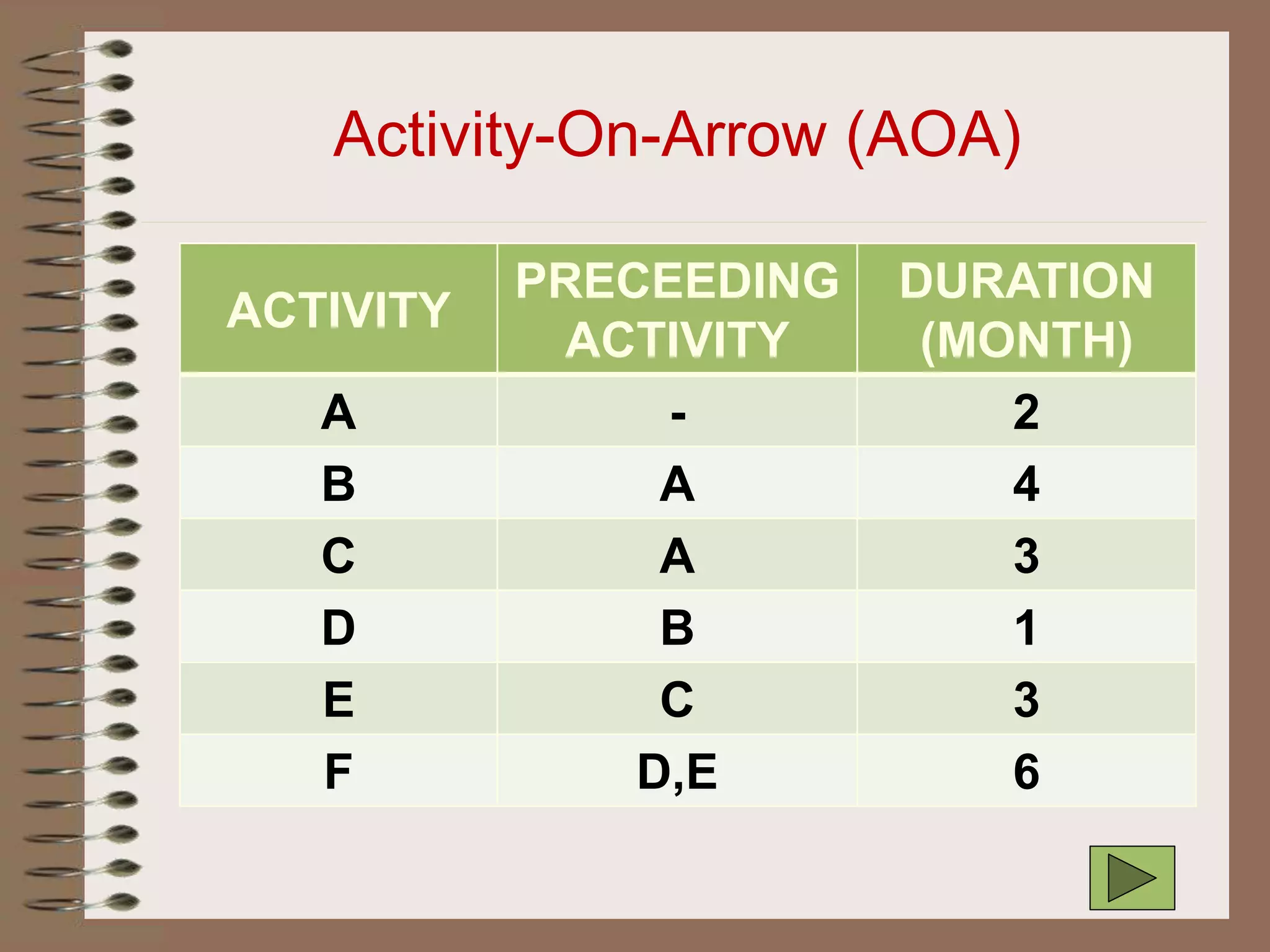

(MONTH)
A - 2
B A 4
C A 3
D B 1
E C 3
F D,E 6

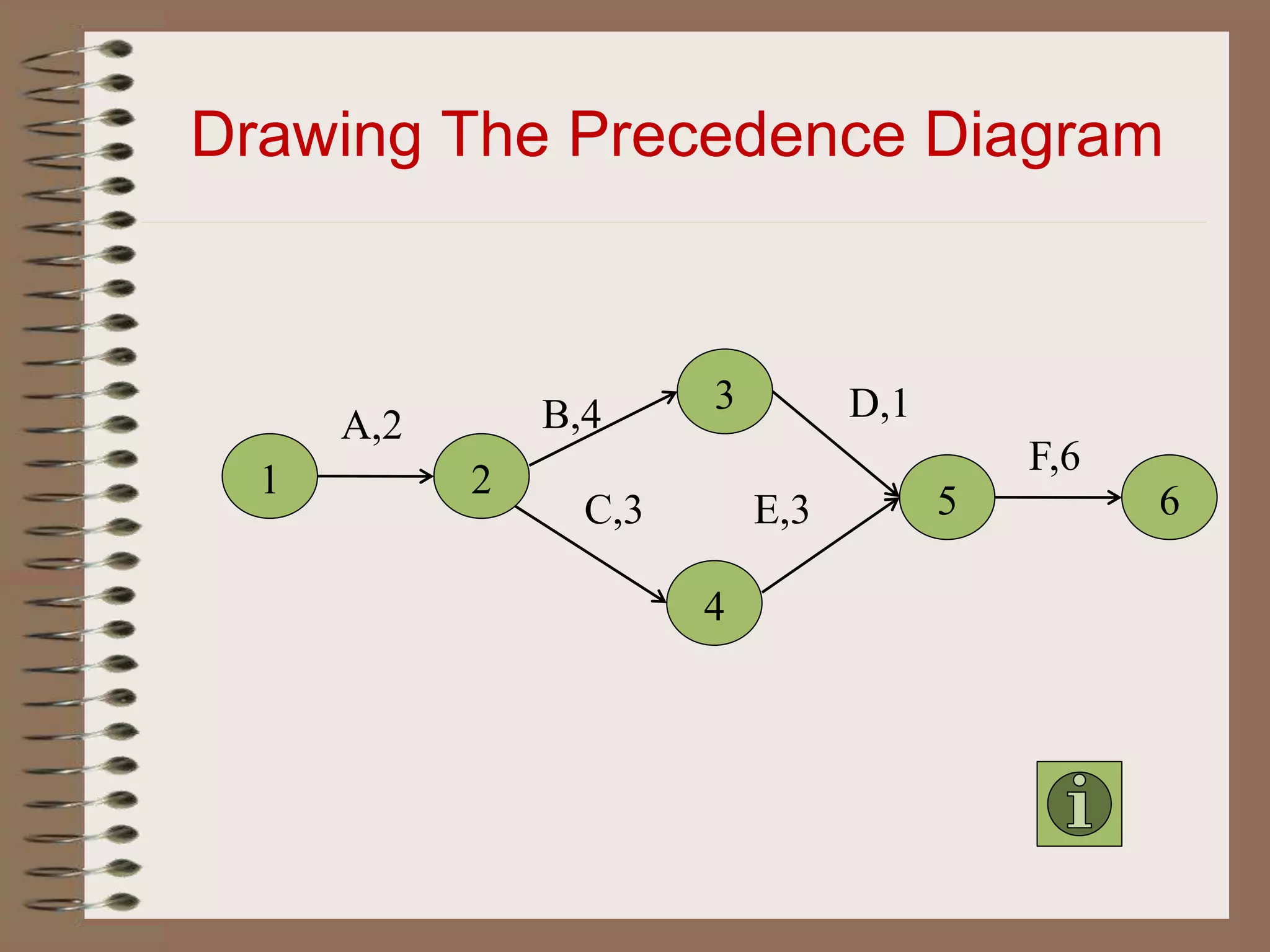

Drawing The Precedence Diagram
1 2
A,2 B,4 3
4
C,3 5
D,1
E,3
F,6
6

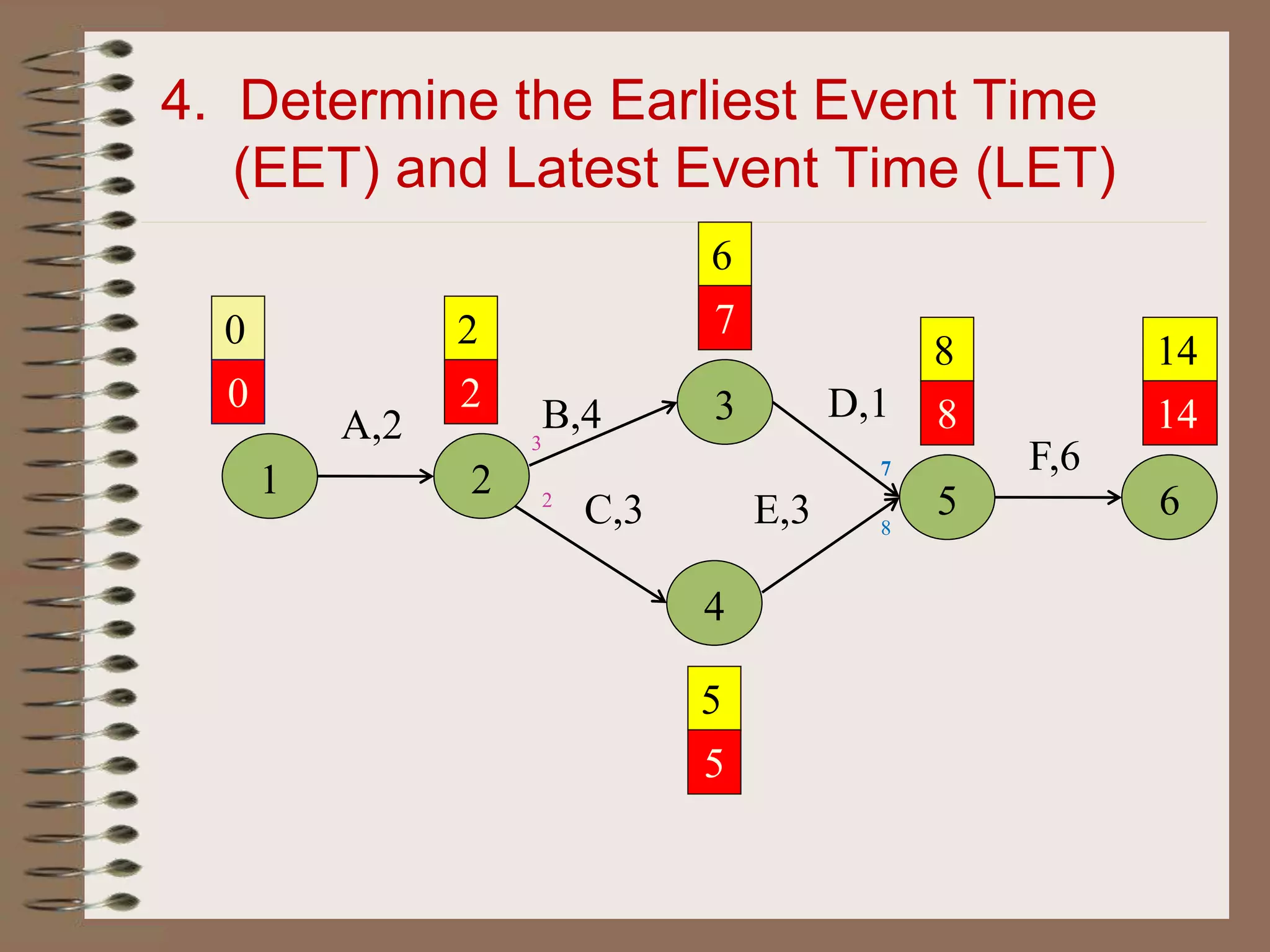

4. Determine the Earliest Event Time
(EET) and Latest Event Time (LET)
1 2
A,2 B,4 3
4
C,3 5
D,1
E,3
F,6
6
0
0
2
2
6
5
8 14
7
5
8 14
8
7
3
2

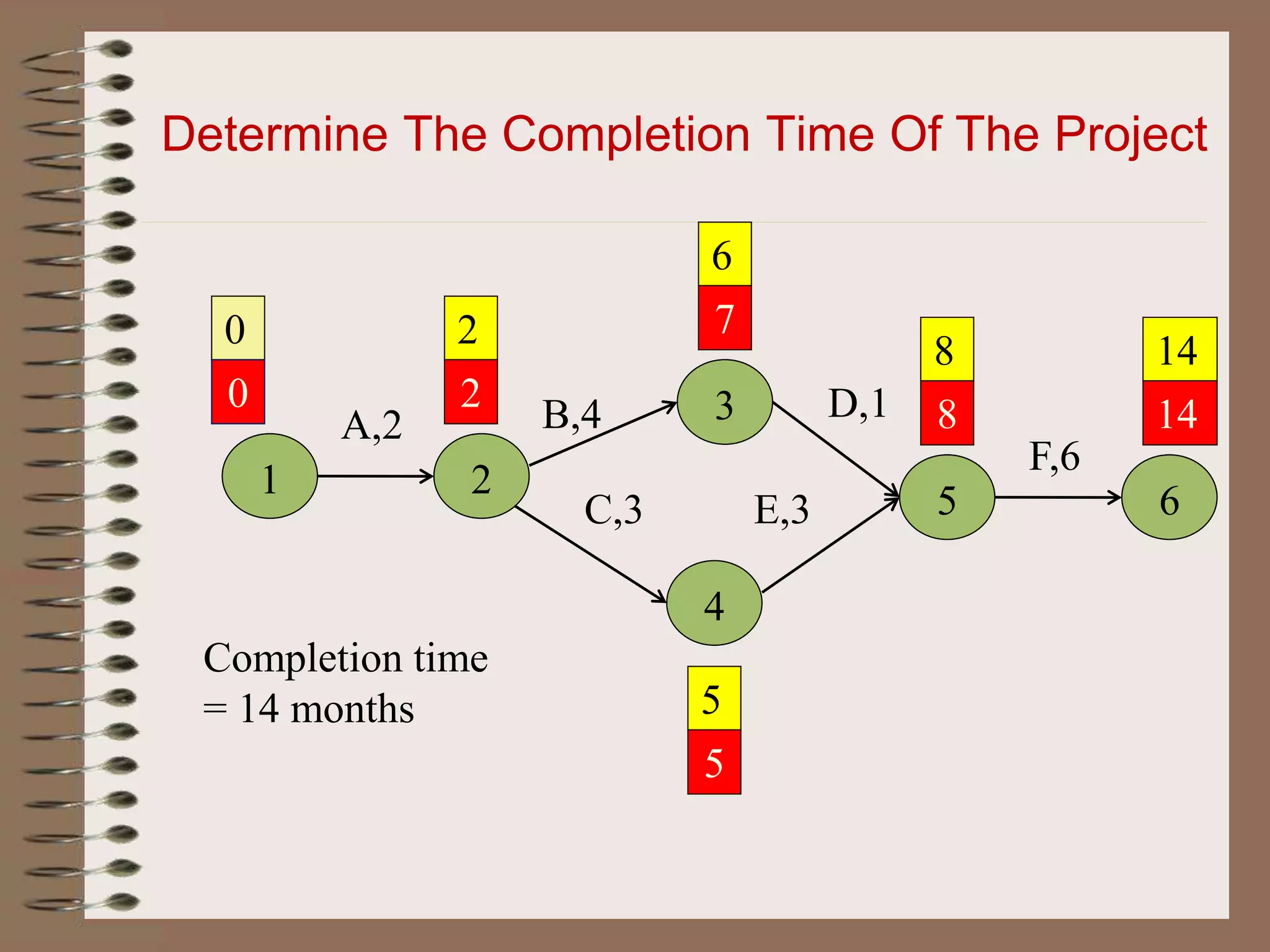

Determine The Completion Time Of The Project
1 2
A,2 B,4 3
4
C,3 5
D,1
E,3
F,6
6
0
0
2
2
6
5
8 14
7
5
8 14
Completion time
= 14 months
Determine the Critical Path (the path whose
activities are expected to consume the most time in
which determines the completion time.
1 2
A,2 B,4 3
4
C,3 5
D,1
E,3
F,6
6
0
0
2
2
6
5
8 14
7
5
8 14
Critical Path =
1 2 4 5 6

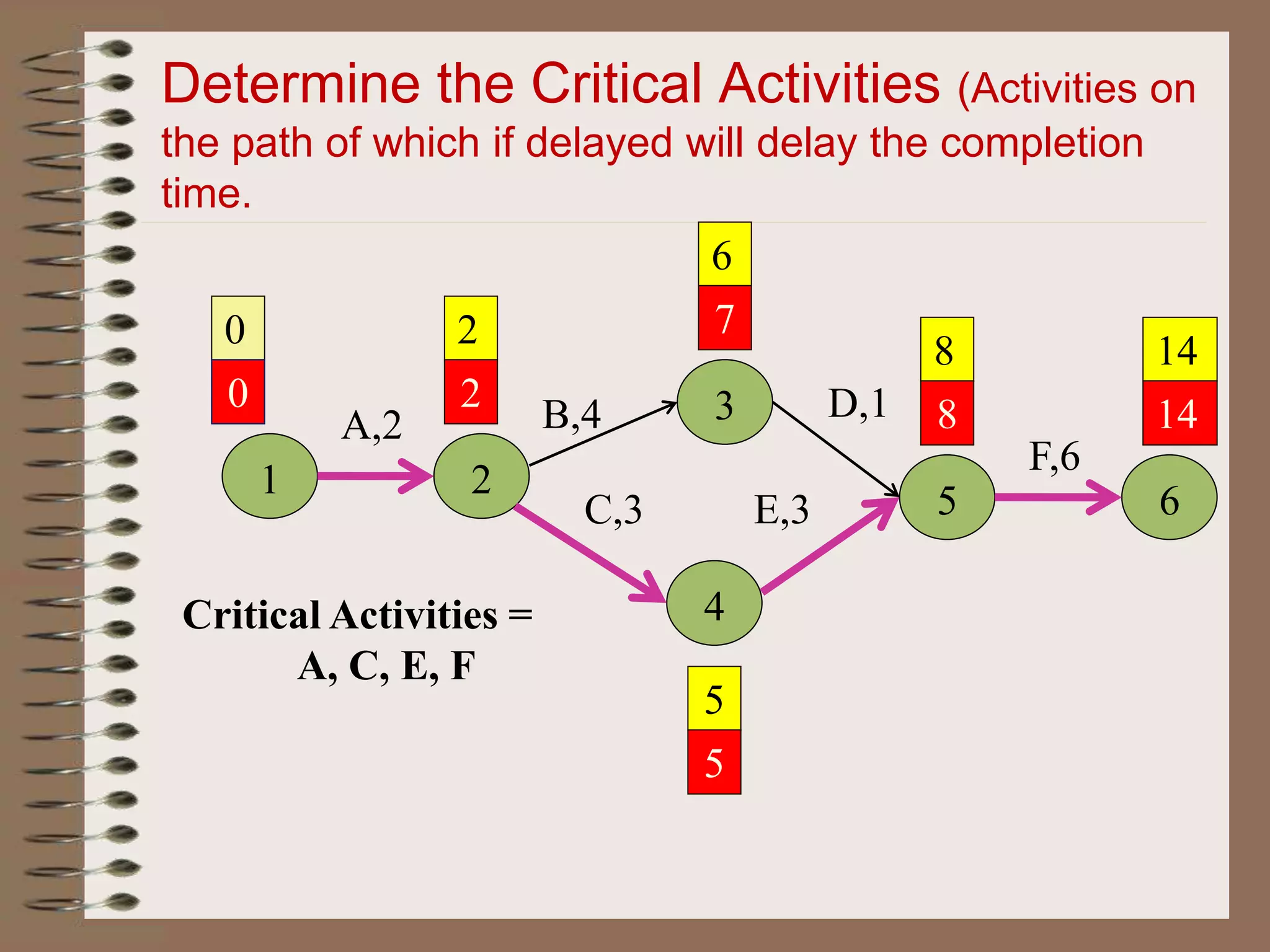

Determine the Critical Activities (Activities on
the path of which if delayed will delay the completion
time.
1 2
A,2 B,4 3
4
C,3 5
D,1
E,3
F,6
6
0
0
2
2
6
5
8 14
7
5
8 14
Critical Activities =
A, C, E, F
DETERMINE THE SLACKS / FLOATS
1. Total Float
- Time can be delayed without affecting the
project completion time
2
B,4
3
2
2
6
7
TFB = 7 – 2 – 4
= 1 month
DETERMINE THE SLACKS / FLOATS

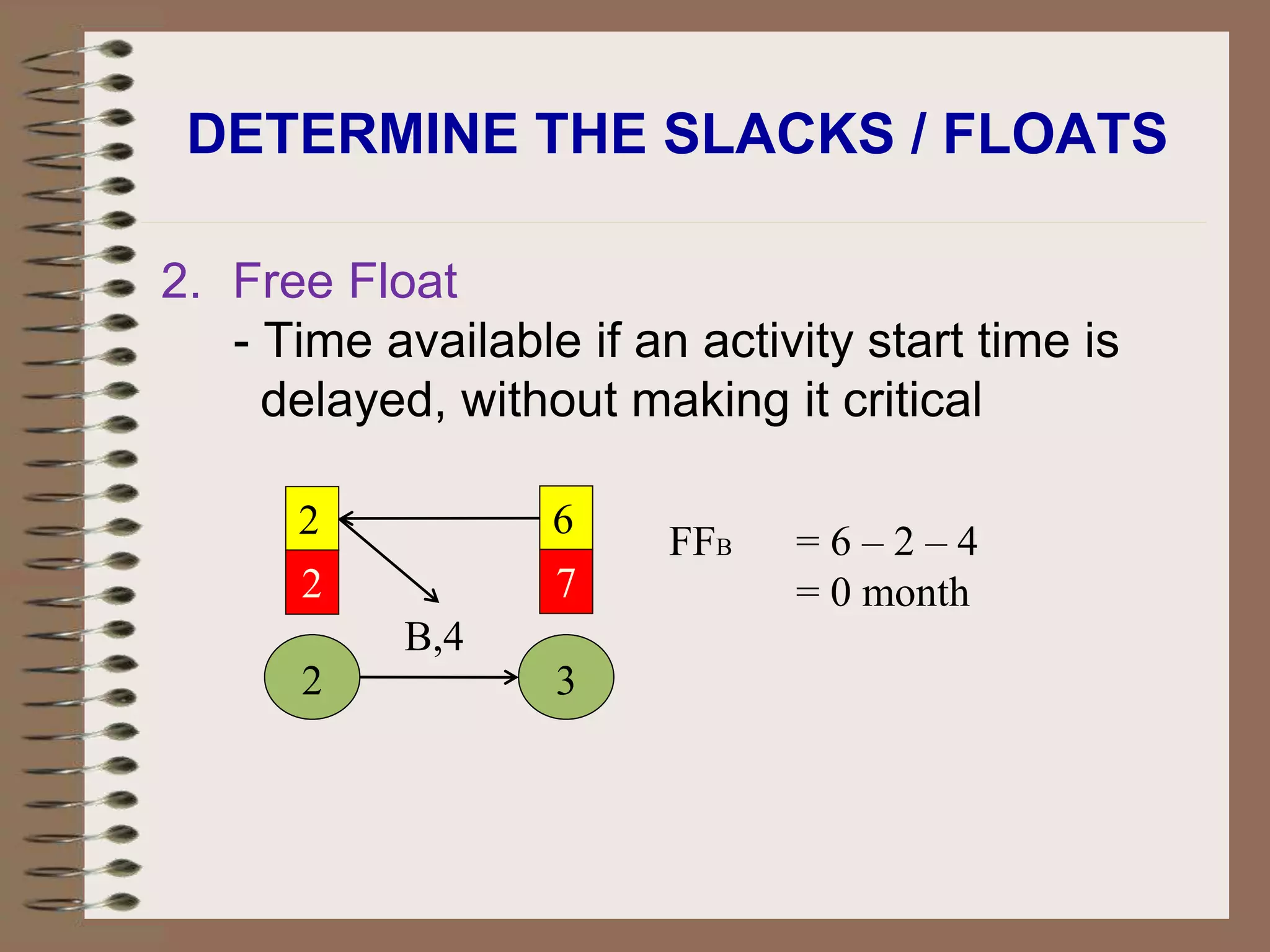

2. Free Float
- Time available if an activity start time is
delayed, without making it critical
2
B,4
3
2
2
6
7
FFB = 6 – 2 – 4
= 0 month

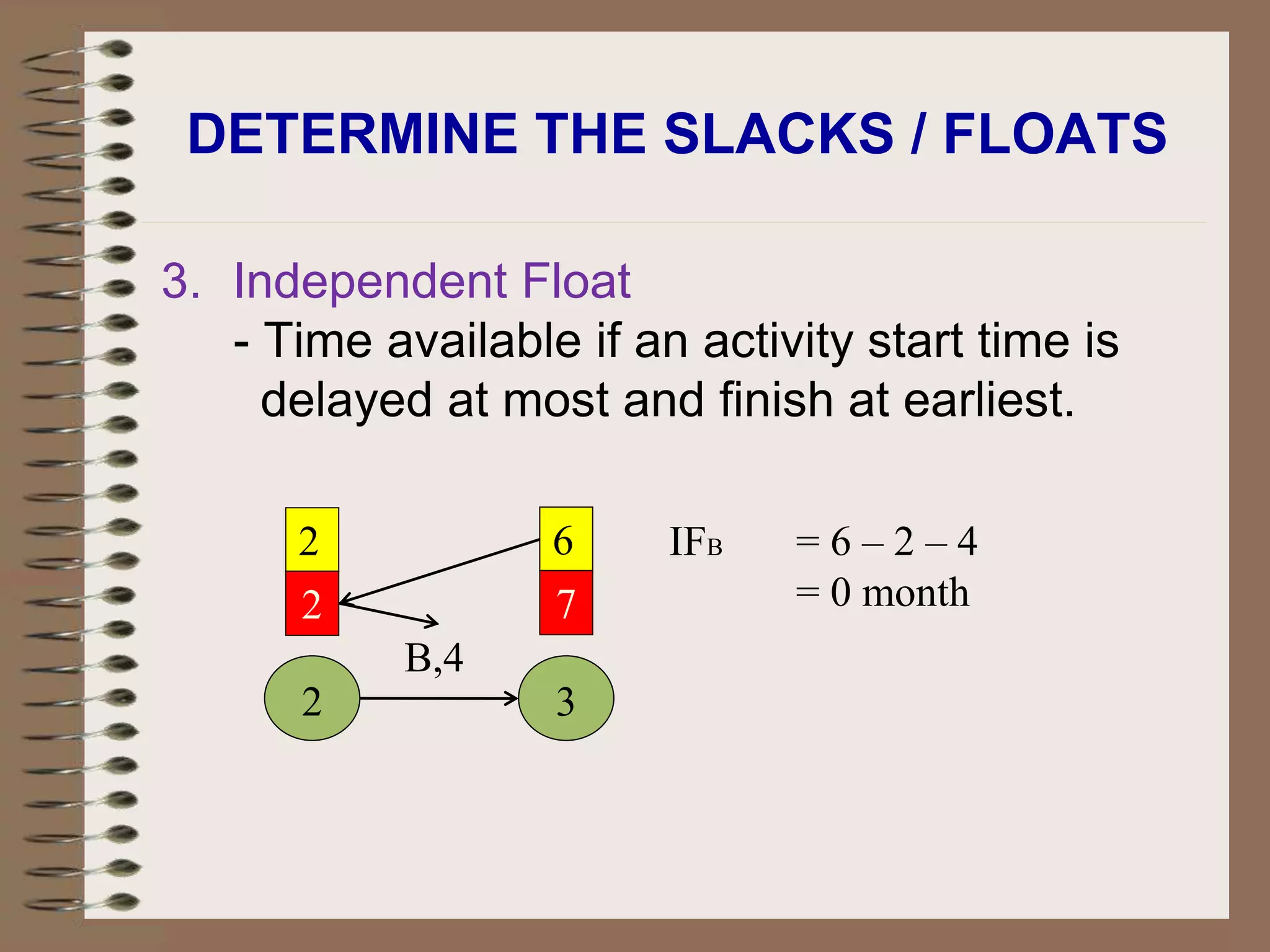

DETERMINE THE SLACKS / FLOATS
3. Independent Float
- Time available if an activity start time is
delayed at most and finish at earliest.
2
B,4
3
2
2
6
7
IFB = 6 – 2 – 4
= 0 month

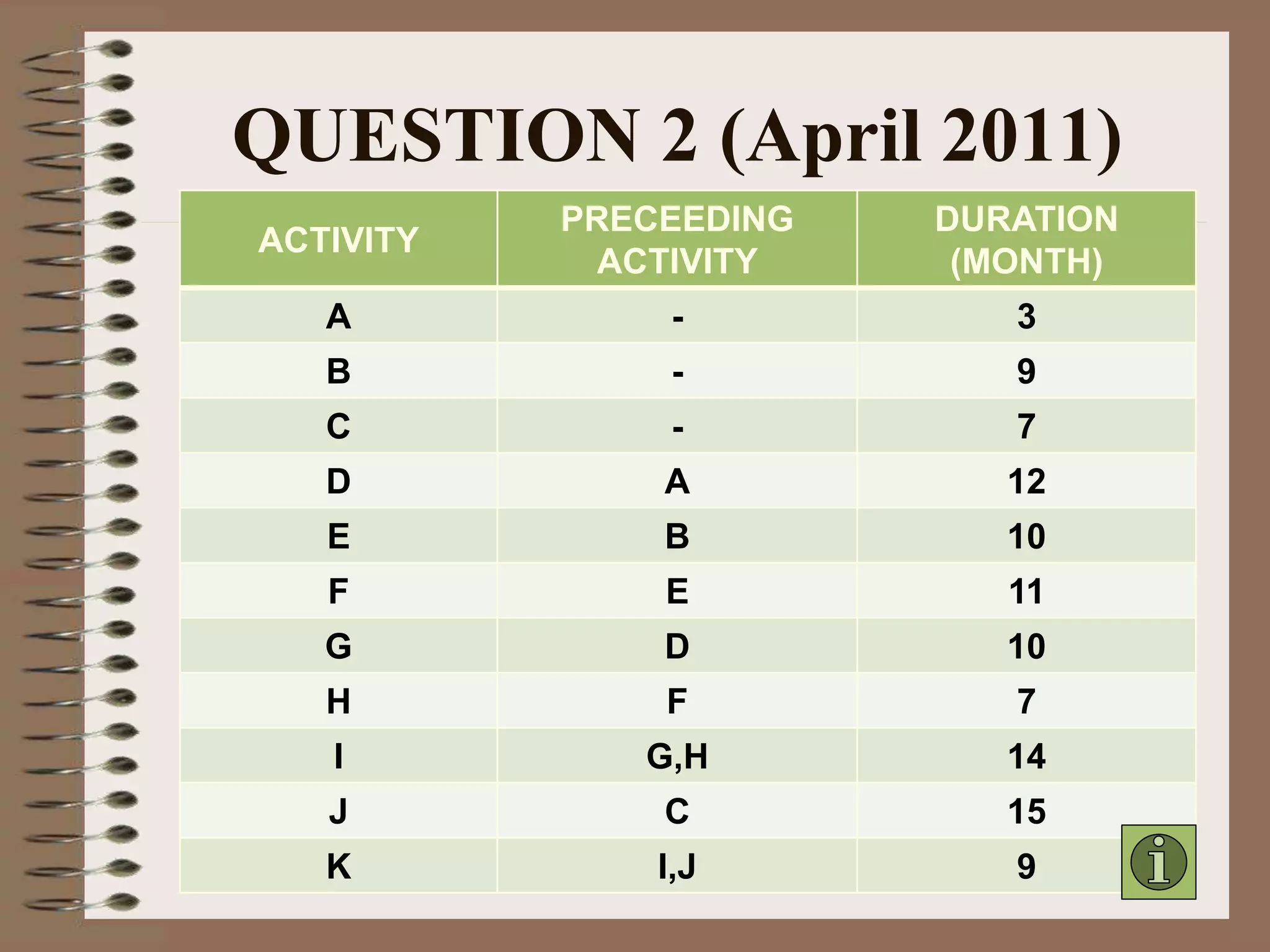

QUESTION 2 (April 2011)
ACTIVITY
PRECEEDING
ACTIVITY
DURATION
(MONTH)
A - 3
B - 9
C - 7
D A 12
E B 10
F E 11
G D 10
H F 7
I G,H 14
J C 15
K I,J 9

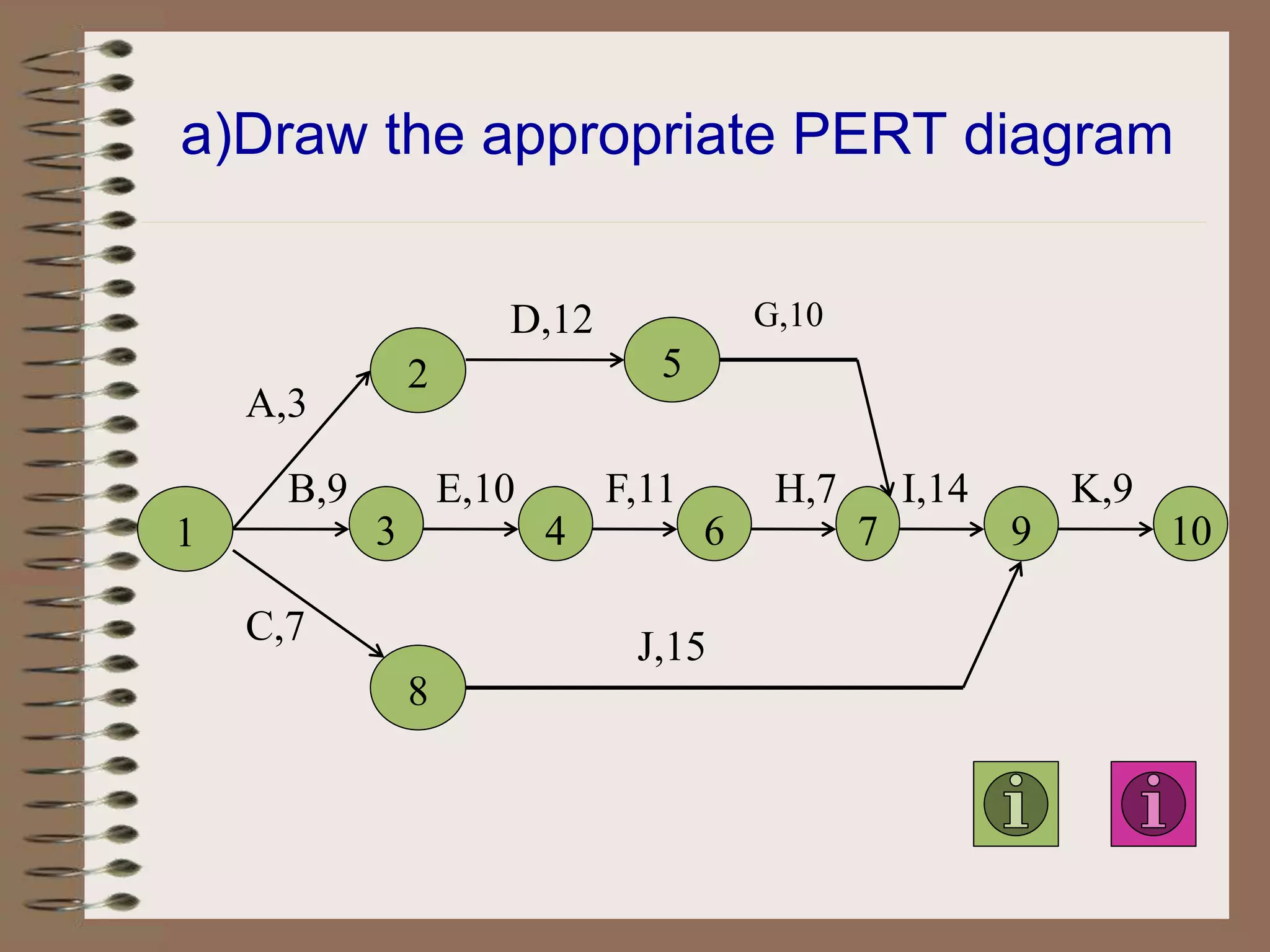

a)Draw the appropriate PERT diagram
1
2
A,3
B,9
3 4
C,7
5
D,12
E,10 F,11
6
G,10
H,7
7
I,14
8
J,15
9
K,9
10

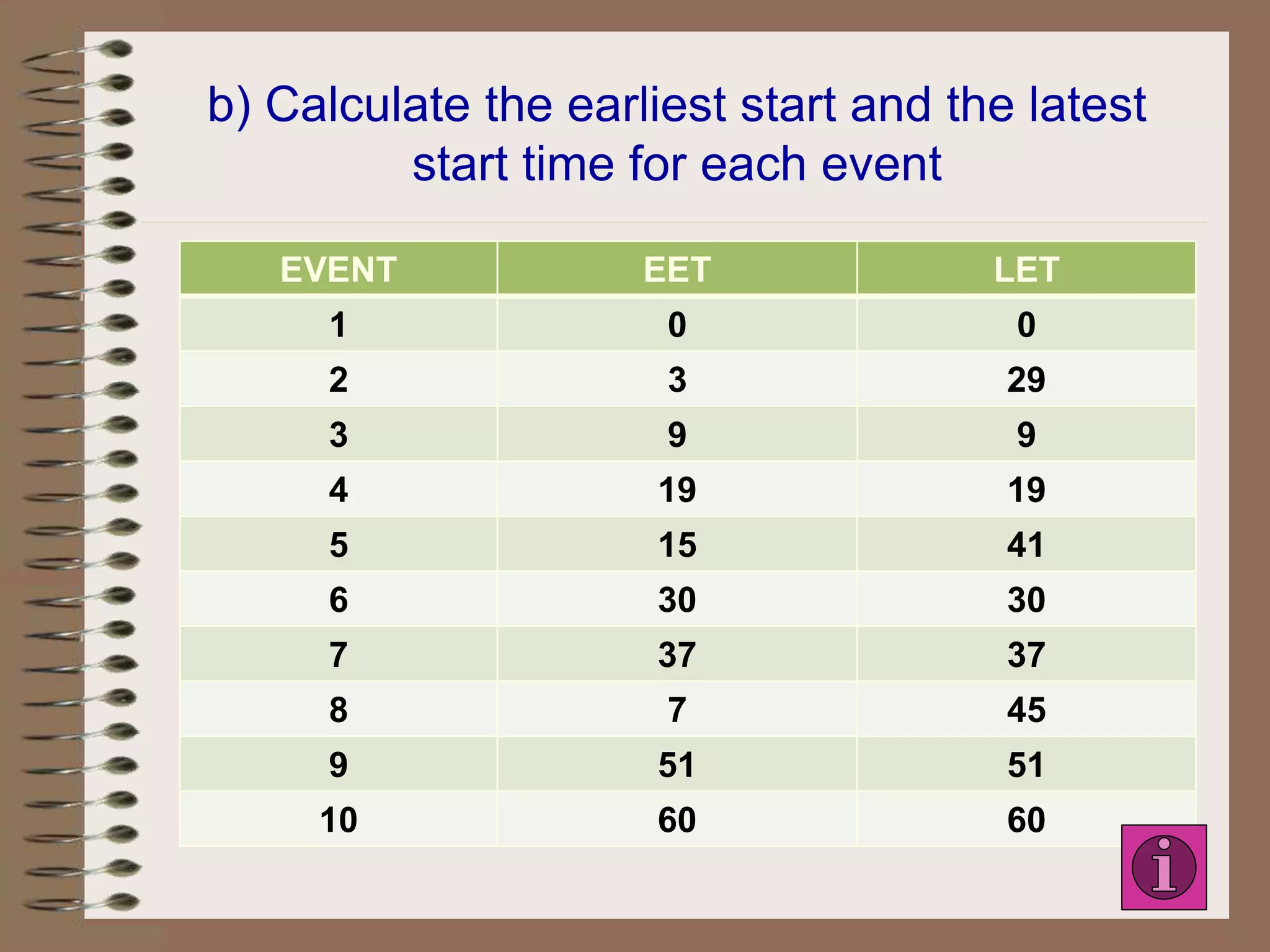

b) Calculate the earliest start and the latest
start time for each event
EVENT EET LET
1 0 0
2 3 29
3 9 9
4 19 19
5 15 41
6 30 30
7 37 37
8 7 45
9 51 51
10 60 60

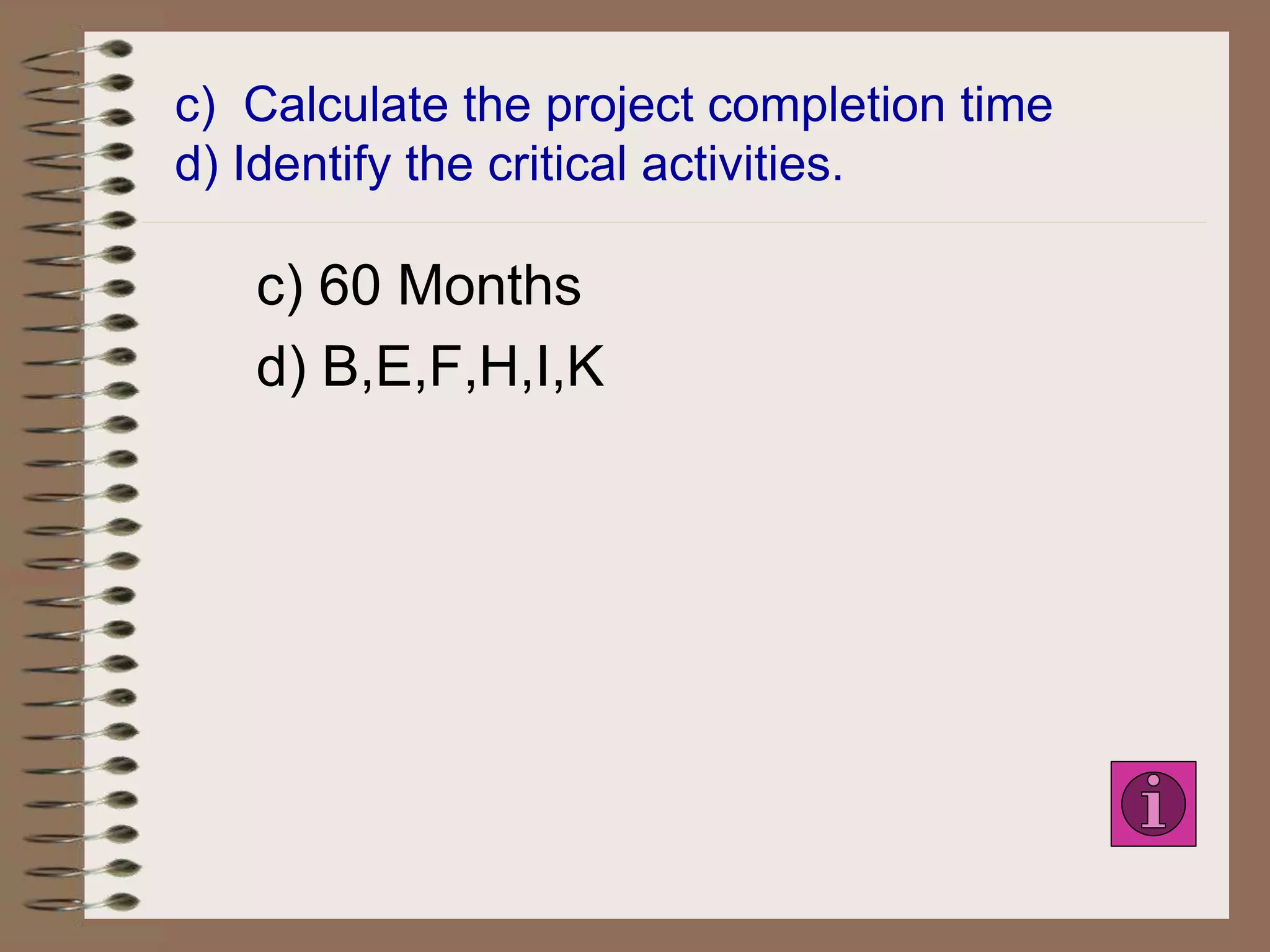

c) Calculate the project completion time
d) Identify the critical activities.
c) 60 Months
d) B,E,F,H,I,K

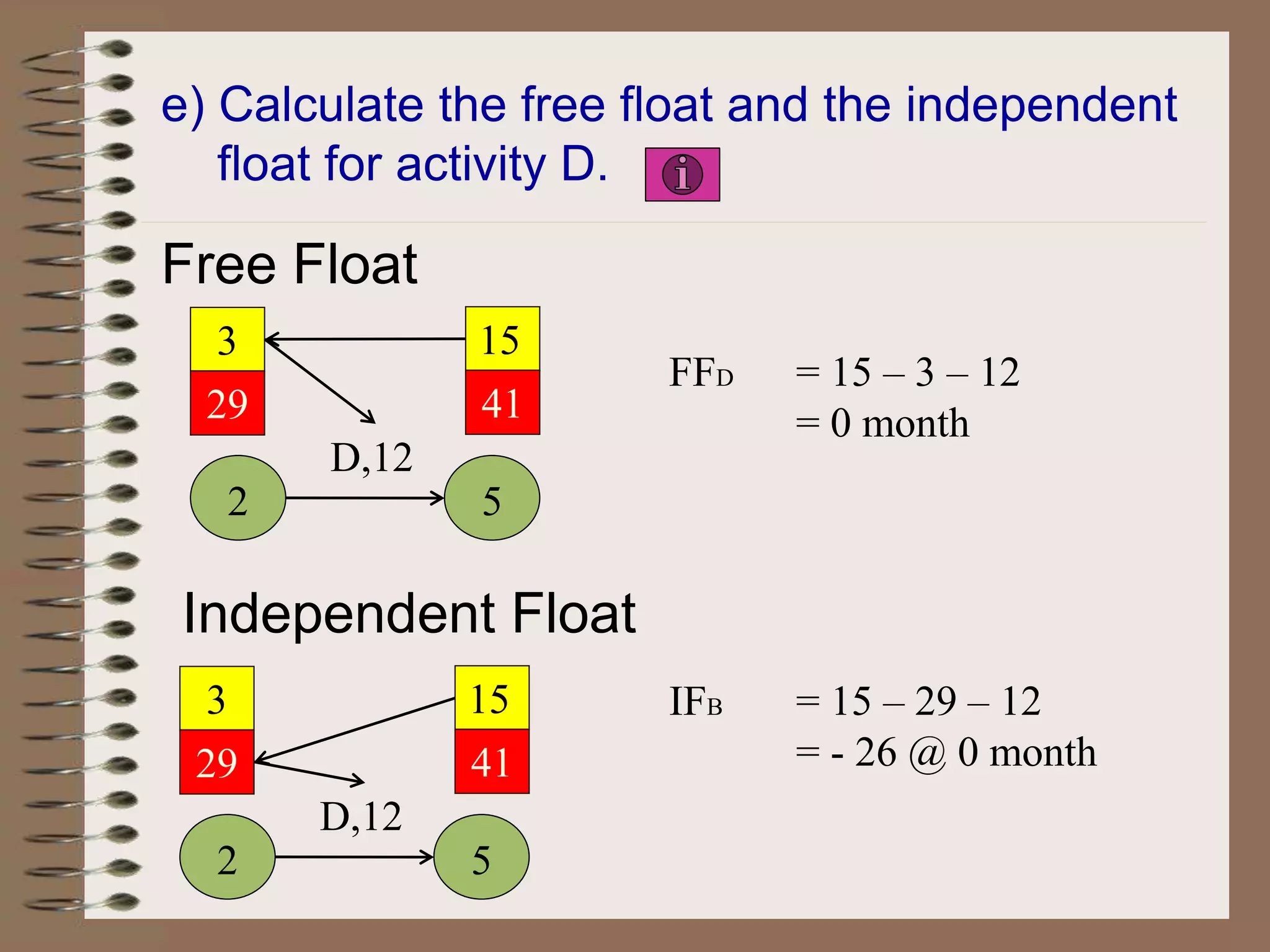

e) Calculate the free float and the independent
float for activity D.
Free Float
2
D,12
5
3
29
15
41
FFD = 15 – 3 – 12
= 0 month
IFB = 15 – 29 – 12
= - 26 @ 0 month
2
D,12
5
3
29
15
41
Independent Float

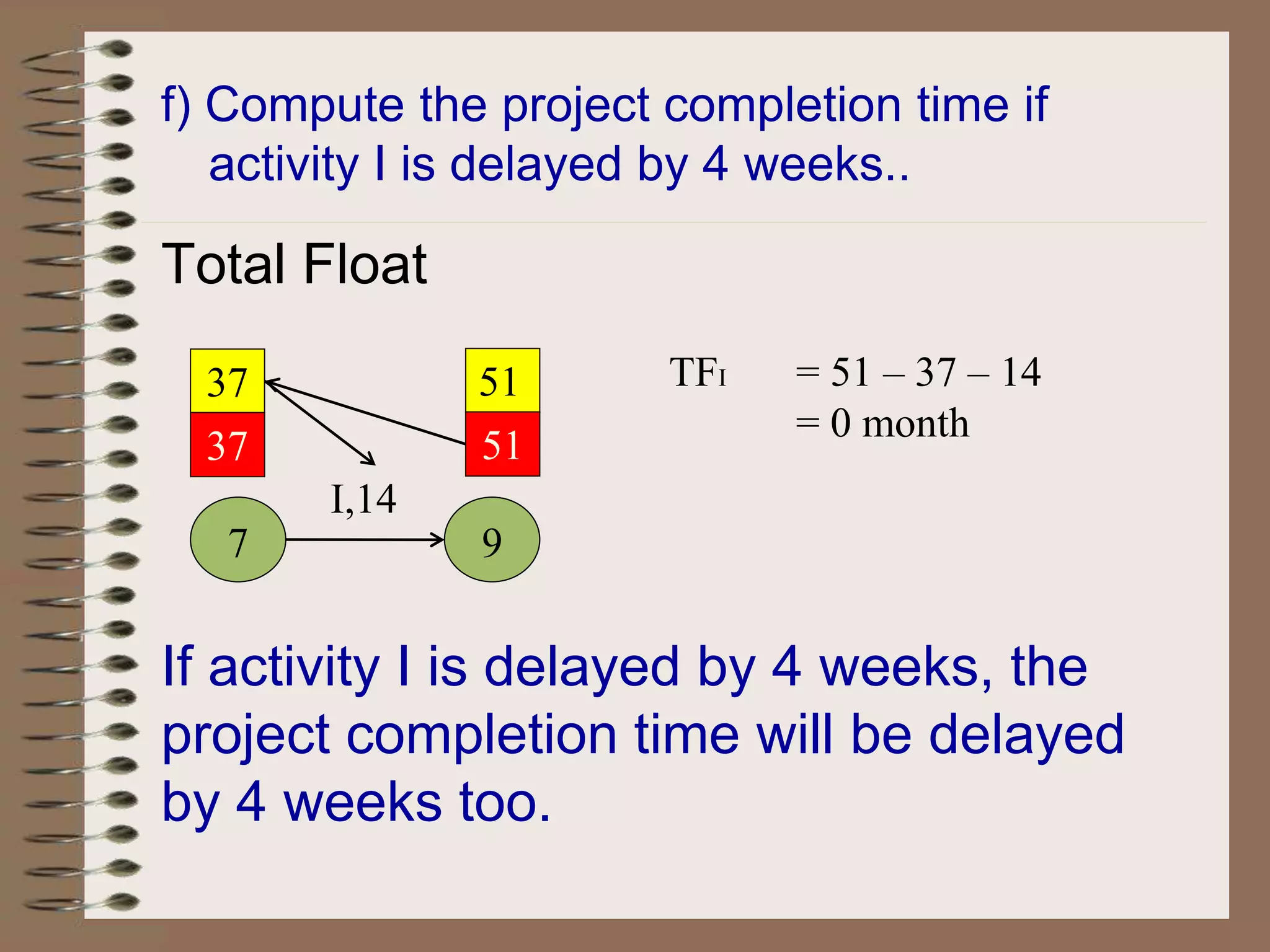

f) Compute the project completion time if
activity I is delayed by 4 weeks..
Total Float
7
I,14
9
37
37
51
51
TFI = 51 – 37 – 14
= 0 month
If activity I is delayed by 4 weeks, the
project completion time will be delayed
by 4 weeks too.

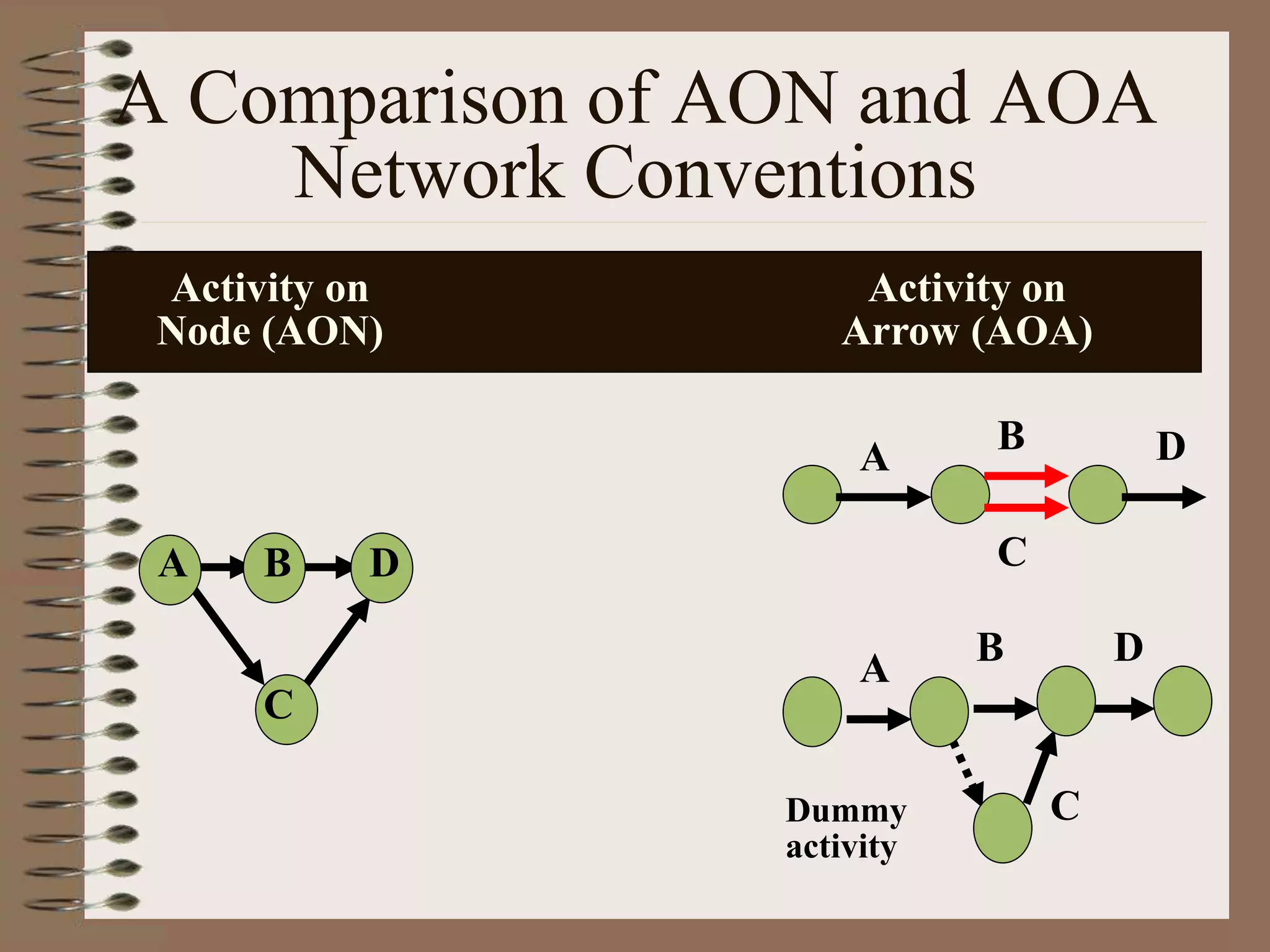

A Comparison of AON and AOA
Network Conventions
Activity on Activity on
Node (AON) Arrow (AOA)
A
C
DB
A B
C
D
Dummy
activity
A
B
C
D
Dummy Activity

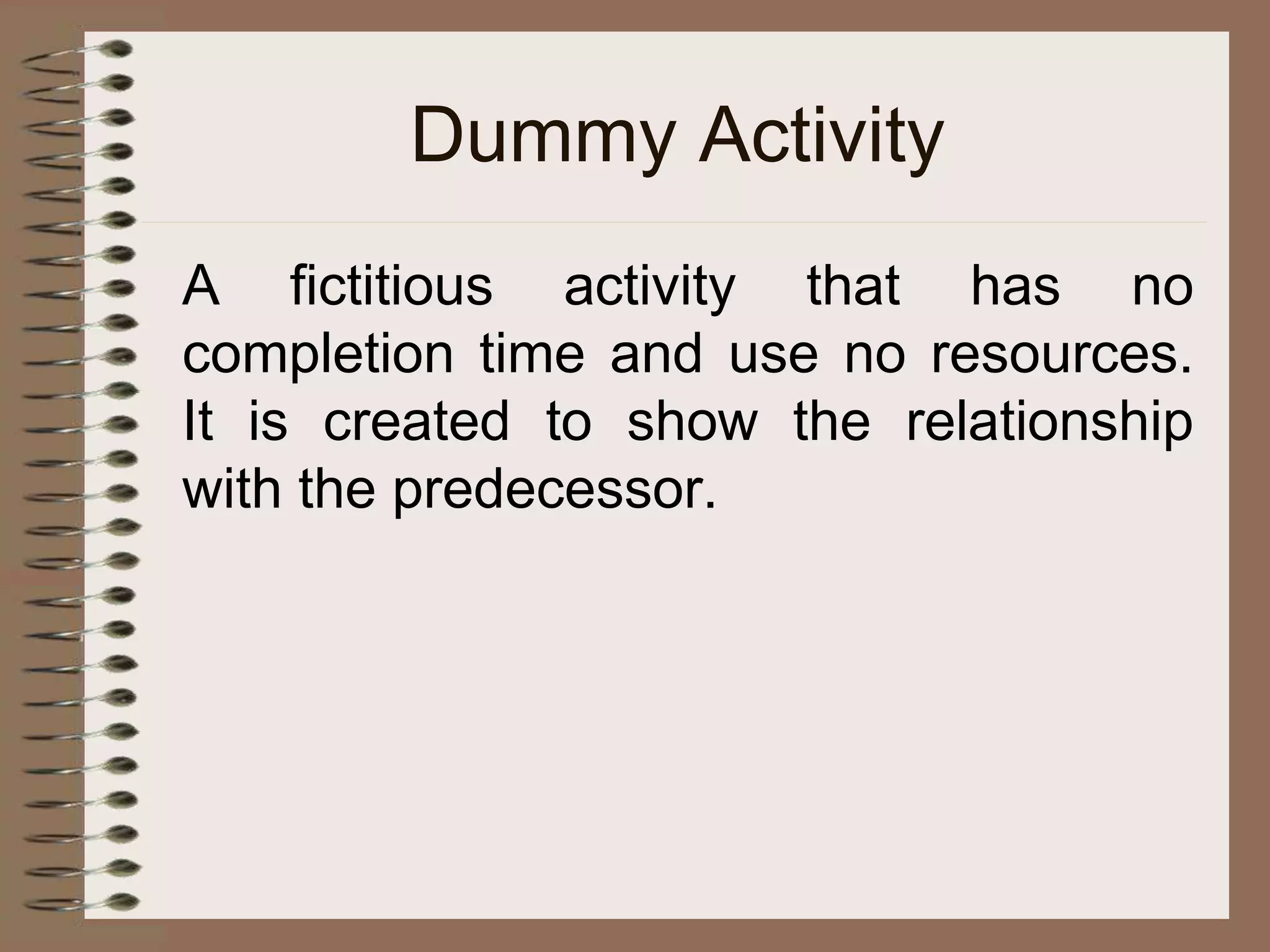

A fictitious activity that has no
completion time and use no resources.
It is created to show the relationship
with the predecessor.

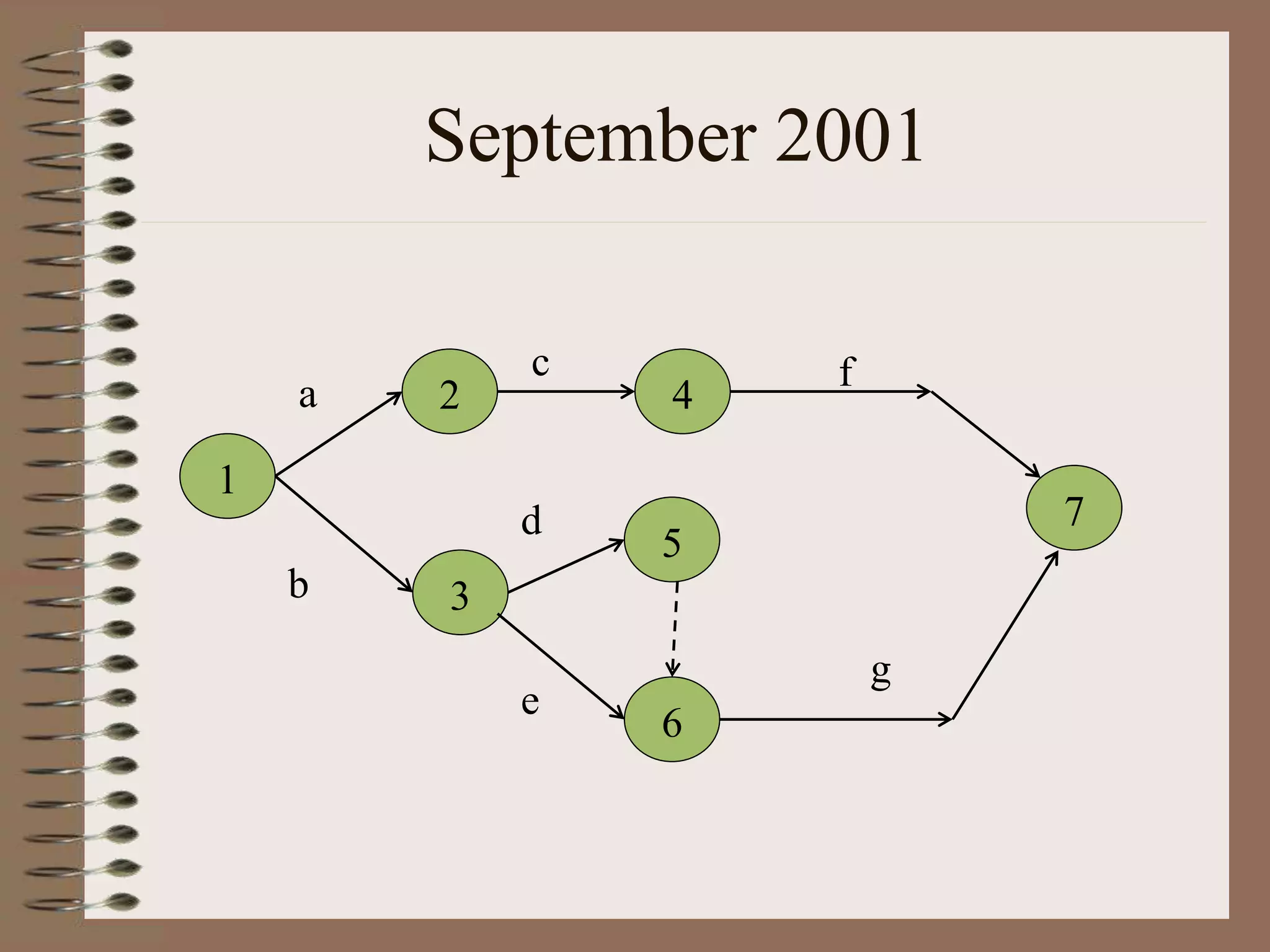

September 2001
1
2a
b 3
4
c
5
d
e
f
6
7
g
IMPORTANT TERMS
 Activity
 Event
 Activity-On-Node Convention
 Activity-On-Arrow Convention
 Precedence Relationship
 Path
 Critical Path
 Slack/Float
 Dummy Activitiy

Chapter 6 project management

  • 1.
  • 2.
    Chapter Outline 6.1 Definitionof project management 6.2 Three stages of project management 6.3 Project management technique- Critical Path Method
  • 3.
    6.0 WHAT ISPROJECT? A series of related jobs that are usually directed toward some major output and require a significant period of time to perform
  • 4.
    The planning, directingand controlling resources (i.e. people, equipment, material) to meet the technical, cost and time constraints of the project. 6.1 WHAT IS PROJECT MANAGEMENT?
  • 5.
    6.2 Three Stagesof Project Management a) Project Planning – Developing a course of action about a specific project. It involves with the activities such as description of the goal, specification of the final output, resources, completion time, results and priority, team organization need to be formed, project manager, forecast and budget. b) Project Scheduling – establishes the times for each activity in a project and it also involves with tying the resources the resources to specific activities and related to each other. c) Project Controlling – monitor the resources , costs, quality and budgets to compare the actual and planned progress of each activity. It is able to identify the activities either behind or ahead schedule. It also includes revising and changing plans, as well as shifting resources to meet time, cost and quality demand.
  • 6.
    Objectives of PM 1.Avoid unnecessary delay and costs 2. Complete projects successfully according to time and costs
  • 7.
    THREE PROJECT MANAGEMENT TECHNIQUES 1.Project Evaluation and Review Technique (PERT) - Never performed project; can handle uncertainties and able to estimate activity time probability.
  • 8.
    THREE PROJECT MANAGEMENT TECHNIQUES 2.Critical Path Method (CPM) - Most activities are similar to previous projects. Activities times known. 3. Gantt Chart - showing activity to perform at the time; which activity is on schedule or behind schedule
  • 9.
    1. When willthe entire project be completed? 2. What are the critical activities or tasks in the project? 3. Which are the noncritical activities? 4. What is the probability the project will be completed by a specific date? Questions PERT & CPM Can Answer
  • 10.
    A Simple GanttChart Time J F M A M J J A S Design Prototype Test Revise Production
  • 11.
    APPLICATION of PM(CPM ) Step 1 : Defining the project and WBS Step 2 : Develop precedences Step 3 : Draw CPM network Step 4 : Compute the completion time Step 5 : Use the network to plan, schedule and control the project.
  • 12.
    Step 3 :Draw CPM network Methods of drawing: 1. Activity-On-Node (AON) - use circles to represent project activity with arrow linking them together to show the sequence in which they are to be performed. 1. Activity-On-Arrow (AOA) - use arrow to represent the project activity with circles connecting predecessor and successor activities.
  • 13.
    A Comparison ofAON and AOA Network Conventions Activity on Activity Activity on Node (AON) Meaning Arrow (AOA) 1 2 3 4 A comes before B, which comes before C. (a) A B C BA C 3 4 1 2 A and B must both be completed before C can start. (b) A C C B A B 1 2 3 4 B and C cannot begin until A is completed. (c) B A C A B C
  • 14.
    Activity-On-Node (AON) ACTIVITY PRECEEDING ACTIVITY DURATION (Days) A -1 B A 4 C A 3 D A 7 E B 6 F C,D 2 G E,F 7 H D 9 I G,H 4
  • 15.
    a) Construct thenetwork for this project A B 1 4 C D 3 F 4 9 7E 7 6 2 G H I
  • 16.
    b) Calculate theEarliest Start (ES), Earliest Finish (EF), Latest Start (LS), Latest Finish (LF) and Slack time for each activity. A B 1 C D 3 F 4 9 7E 7 6 2 G H I 0 0 1 1 1 1 5 5 5 5 11 11 11 11 18 18 1 6 4 9 1 2 8 9 8 9 10 11 8 9 17 18 18 18 22 22 4 Yellow- Earliest Start & Earliest Finish Red- Latest Start & Latest Finish
  • 17.
    1) ES -all predecessor activities must be able to complete before and activity can be start. 2) EF – the earliest time activity can be completed 3) LS – all following activity must be completed without delaying the entire project. 4) LF – the latest time and activity can be completed and still maintain the project critical path time. ES EF LS LF
  • 18.
    Slack Time -activity that can be delayed without affecting completion time activities that is not the critical path C 1 6 4 9 Slack = LF – EF @ LS - ES Slack = 9 – 4 = 5 days D 1 2 8 9 Slack = 9 – 8 = 1 day Slack (H) = 18 – 17 = 1 day Slack (F) = 11 – 10 = 1 day
  • 19.
    c) Identify theCritical Path A B E G I 0 0 1 1 1 1 5 5 5 5 11 11 11 11 18 18 18 18 22 22 Take out all the available path from the diagram; 1) A,B,E,G,I = 22 days- ‘CHOOSE THE HIGHEST TIME’ 2) A,C,F,G,H,I = 17 days 3) A,D,F,G,H = 21 days 4) A,D,H,I = 21 days
  • 20.
    d) What wouldhappen if activity F is revised to take four days instead of two? F 2 8 9 10 11 F 4 8 9 10 11 Revised time = 4 daysOriginal time = 2 days
  • 21.
    d) What wouldhappen if activity F is revised to take four days instead of two? F 4 9 7E 6 4 G H I 5 6 11 12 12 12 19 19 8 8 12 12 8 10 17 19 19 19 23 23 D 1 1 8 8 7
  • 22.
    Exercise 1 ACTIVITY PRECEEDINGACTIVITY DURATION (Days) A - 2 B - 3 C A,B 3 D C 3 E C 4 F C,E 3 G B 5 H E 3 I D 6 J D,F 4 K G,H 5 L I,J 3
  • 23.
    a) Construct thenetwork for this project a) Calculate the Earliest Start (ES), Earliest Finish (EF), Latest Start (LS), Latest Finish (LF) and Slack time for each activity. c) Identify the Critical Path
  • 24.
  • 25.
    Drawing The PrecedenceDiagram 1 2 A,2 B,4 3 4 C,3 5 D,1 E,3 F,6 6
  • 26.
    4. Determine theEarliest Event Time (EET) and Latest Event Time (LET) 1 2 A,2 B,4 3 4 C,3 5 D,1 E,3 F,6 6 0 0 2 2 6 5 8 14 7 5 8 14 8 7 3 2
  • 27.
    Determine The CompletionTime Of The Project 1 2 A,2 B,4 3 4 C,3 5 D,1 E,3 F,6 6 0 0 2 2 6 5 8 14 7 5 8 14 Completion time = 14 months
  • 28.
    Determine the CriticalPath (the path whose activities are expected to consume the most time in which determines the completion time. 1 2 A,2 B,4 3 4 C,3 5 D,1 E,3 F,6 6 0 0 2 2 6 5 8 14 7 5 8 14 Critical Path = 1 2 4 5 6
  • 29.
    Determine the CriticalActivities (Activities on the path of which if delayed will delay the completion time. 1 2 A,2 B,4 3 4 C,3 5 D,1 E,3 F,6 6 0 0 2 2 6 5 8 14 7 5 8 14 Critical Activities = A, C, E, F
  • 30.
    DETERMINE THE SLACKS/ FLOATS 1. Total Float - Time can be delayed without affecting the project completion time 2 B,4 3 2 2 6 7 TFB = 7 – 2 – 4 = 1 month
  • 31.
    DETERMINE THE SLACKS/ FLOATS 2. Free Float - Time available if an activity start time is delayed, without making it critical 2 B,4 3 2 2 6 7 FFB = 6 – 2 – 4 = 0 month
  • 32.
    DETERMINE THE SLACKS/ FLOATS 3. Independent Float - Time available if an activity start time is delayed at most and finish at earliest. 2 B,4 3 2 2 6 7 IFB = 6 – 2 – 4 = 0 month
  • 33.
    QUESTION 2 (April2011) ACTIVITY PRECEEDING ACTIVITY DURATION (MONTH) A - 3 B - 9 C - 7 D A 12 E B 10 F E 11 G D 10 H F 7 I G,H 14 J C 15 K I,J 9
  • 34.
    a)Draw the appropriatePERT diagram 1 2 A,3 B,9 3 4 C,7 5 D,12 E,10 F,11 6 G,10 H,7 7 I,14 8 J,15 9 K,9 10
  • 35.
    b) Calculate theearliest start and the latest start time for each event EVENT EET LET 1 0 0 2 3 29 3 9 9 4 19 19 5 15 41 6 30 30 7 37 37 8 7 45 9 51 51 10 60 60
  • 36.
    c) Calculate theproject completion time d) Identify the critical activities. c) 60 Months d) B,E,F,H,I,K
  • 37.
    e) Calculate thefree float and the independent float for activity D. Free Float 2 D,12 5 3 29 15 41 FFD = 15 – 3 – 12 = 0 month IFB = 15 – 29 – 12 = - 26 @ 0 month 2 D,12 5 3 29 15 41 Independent Float
  • 38.
    f) Compute theproject completion time if activity I is delayed by 4 weeks.. Total Float 7 I,14 9 37 37 51 51 TFI = 51 – 37 – 14 = 0 month If activity I is delayed by 4 weeks, the project completion time will be delayed by 4 weeks too.
  • 39.
    A Comparison ofAON and AOA Network Conventions Activity on Activity on Node (AON) Arrow (AOA) A C DB A B C D Dummy activity A B C D
  • 40.
    Dummy Activity A fictitiousactivity that has no completion time and use no resources. It is created to show the relationship with the predecessor.
  • 41.
  • 42.
    IMPORTANT TERMS  Activity Event  Activity-On-Node Convention  Activity-On-Arrow Convention  Precedence Relationship  Path  Critical Path  Slack/Float  Dummy Activitiy
