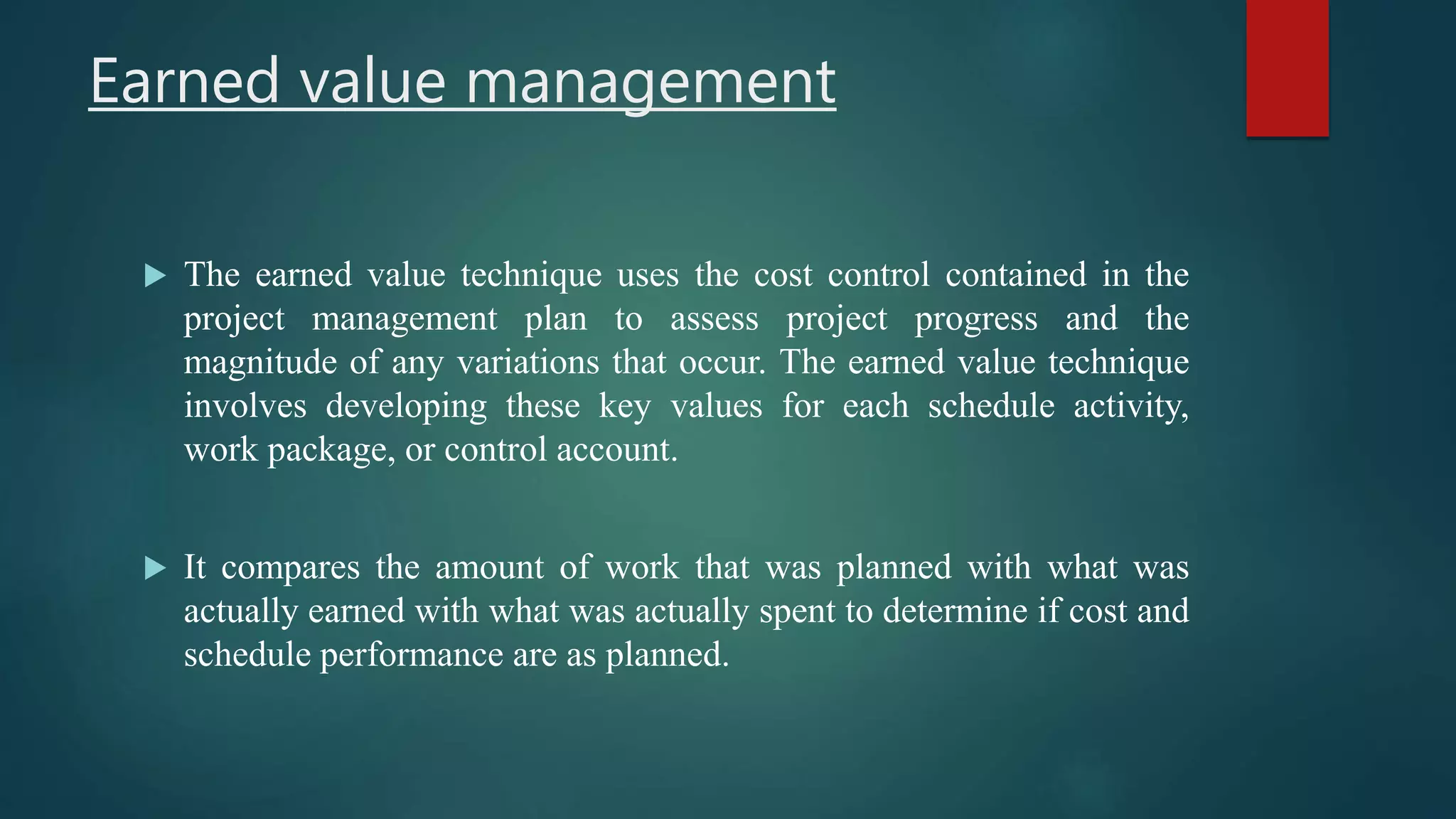

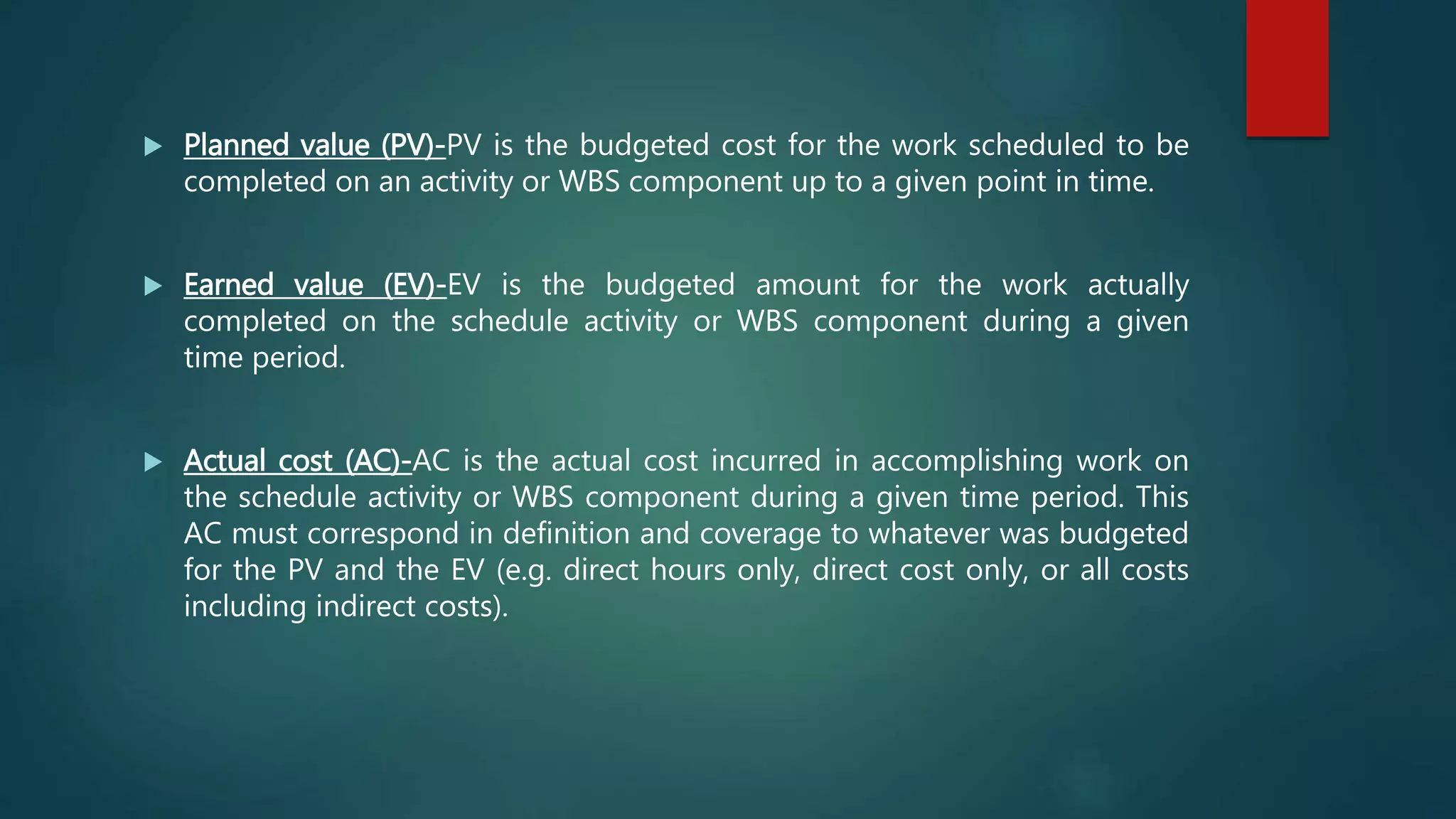

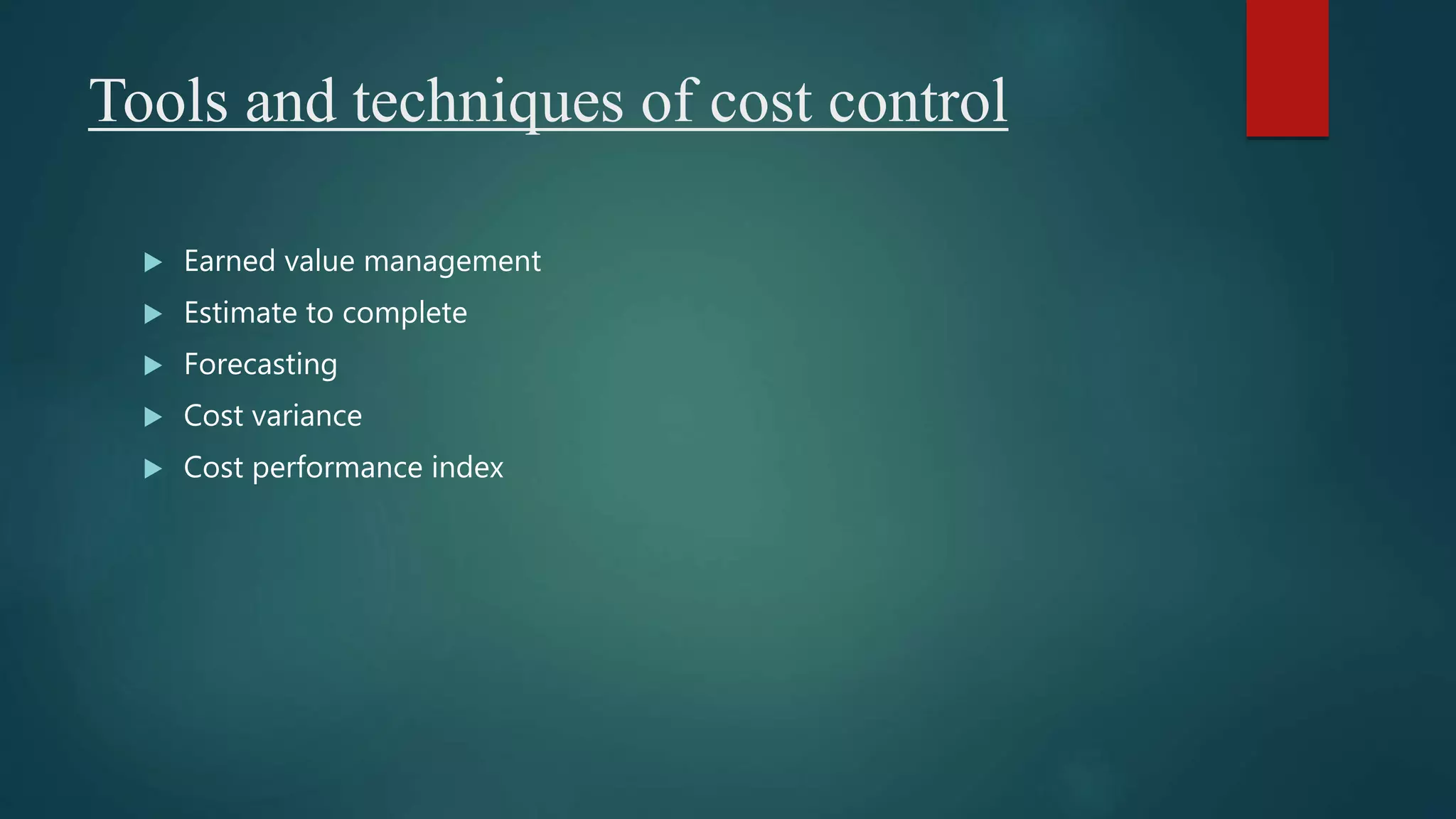

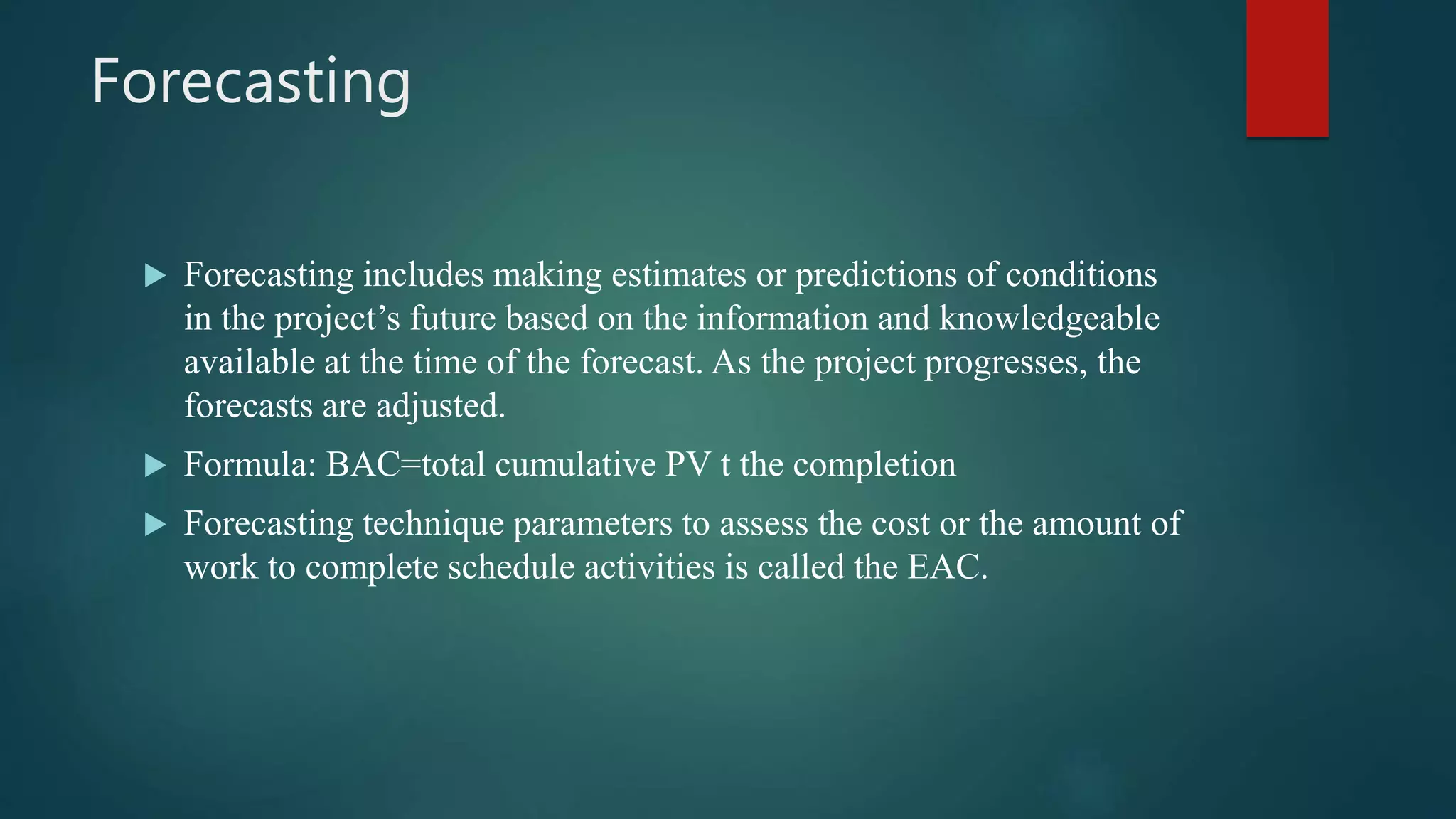

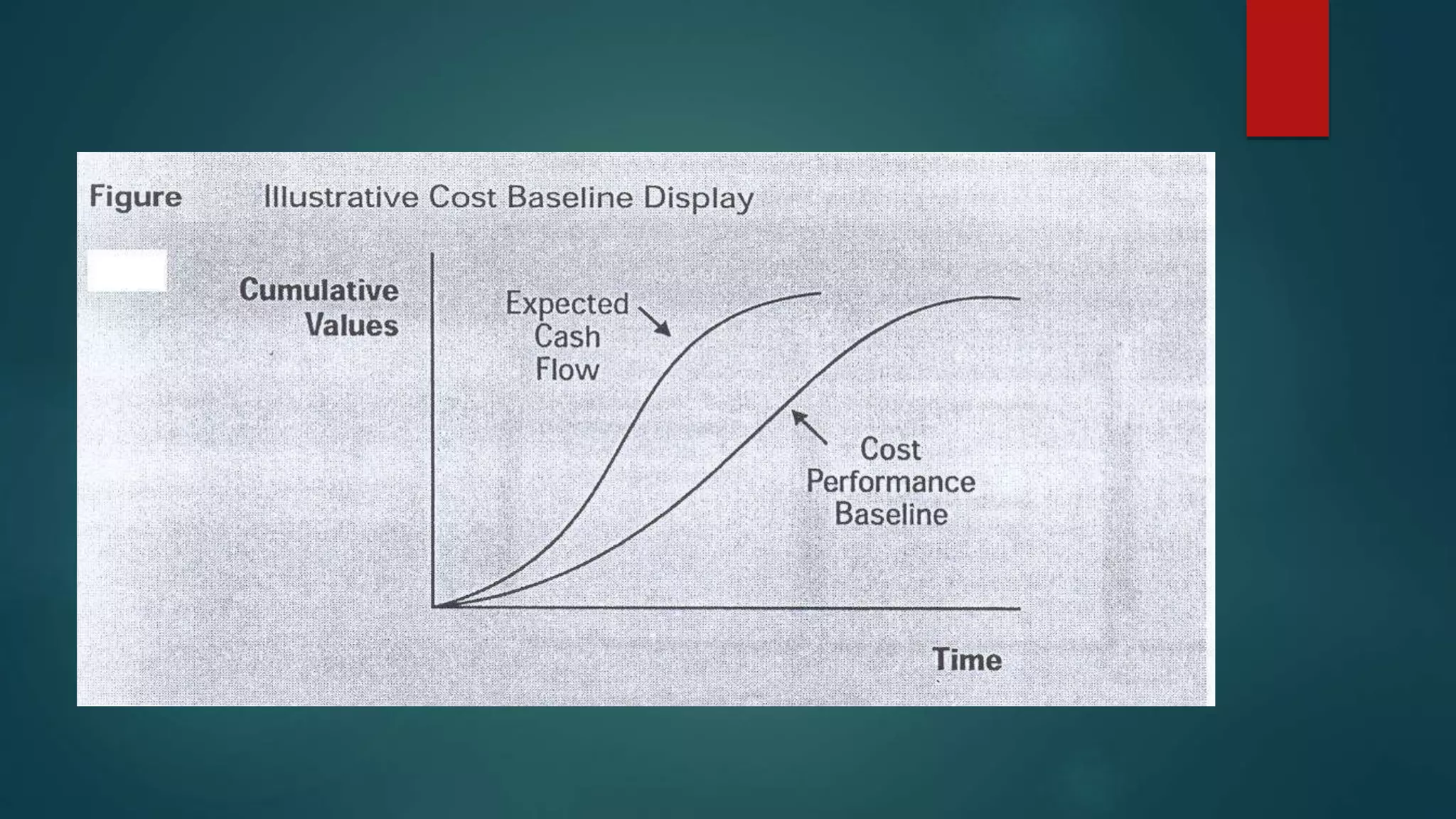

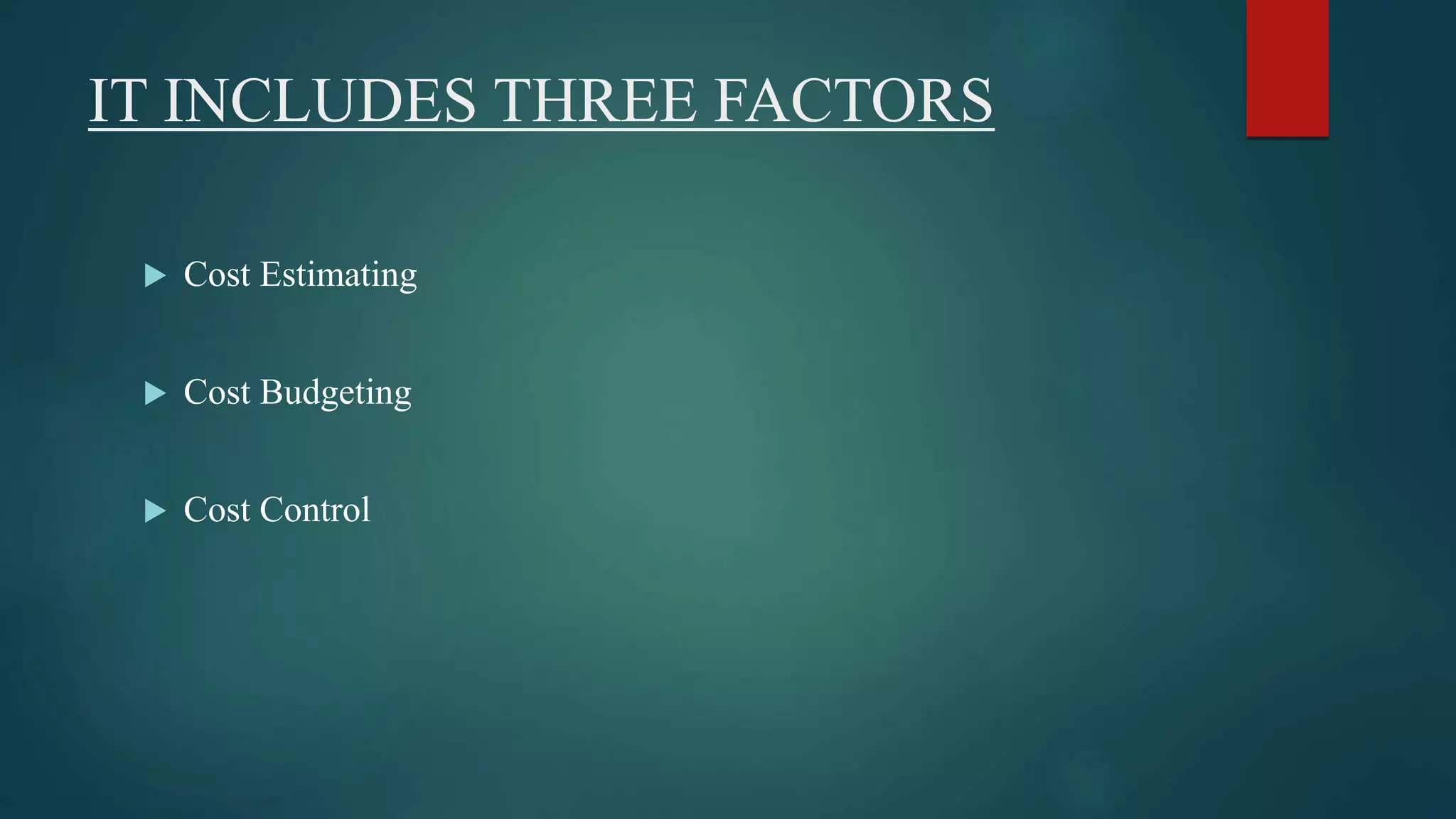

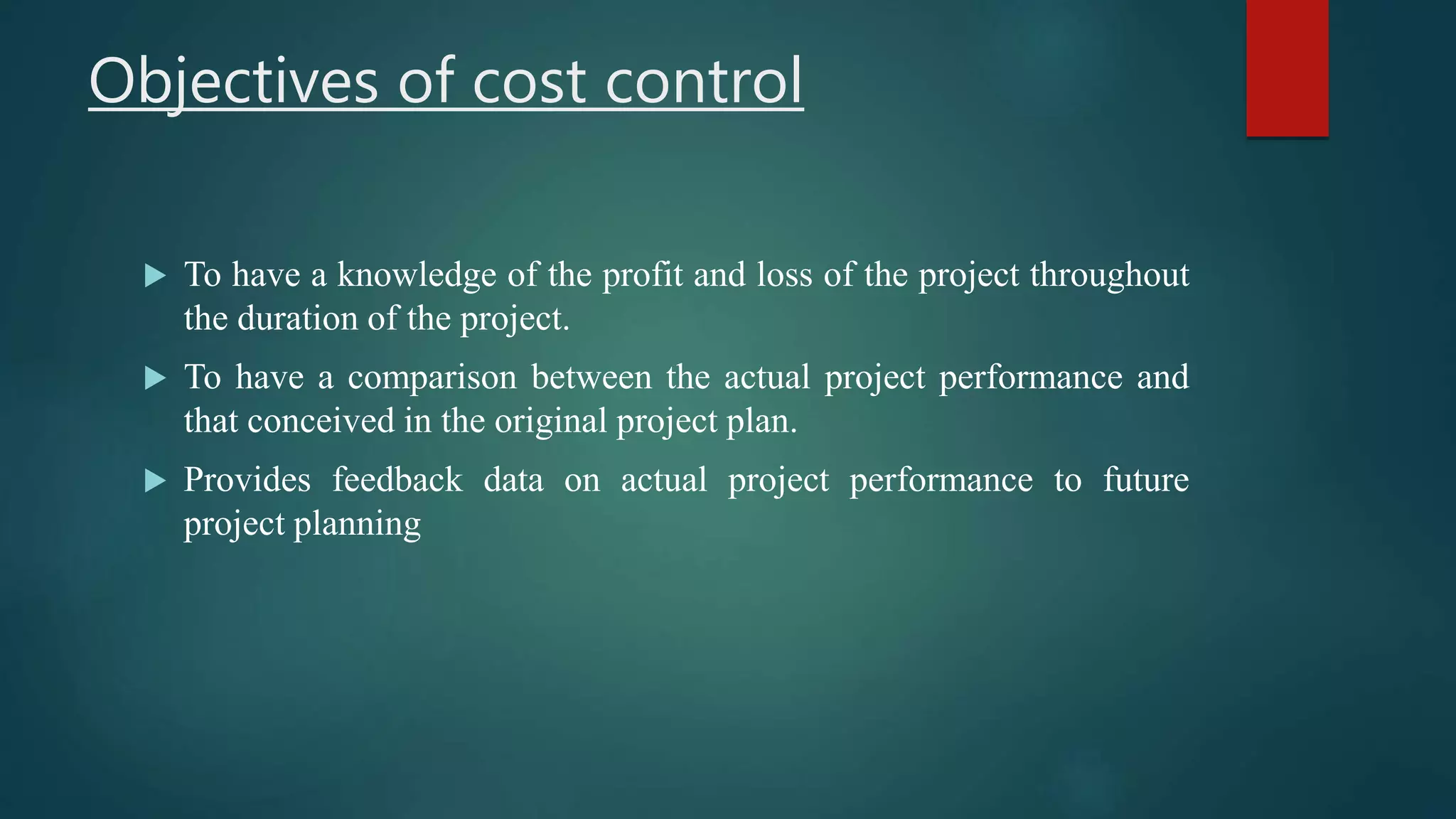

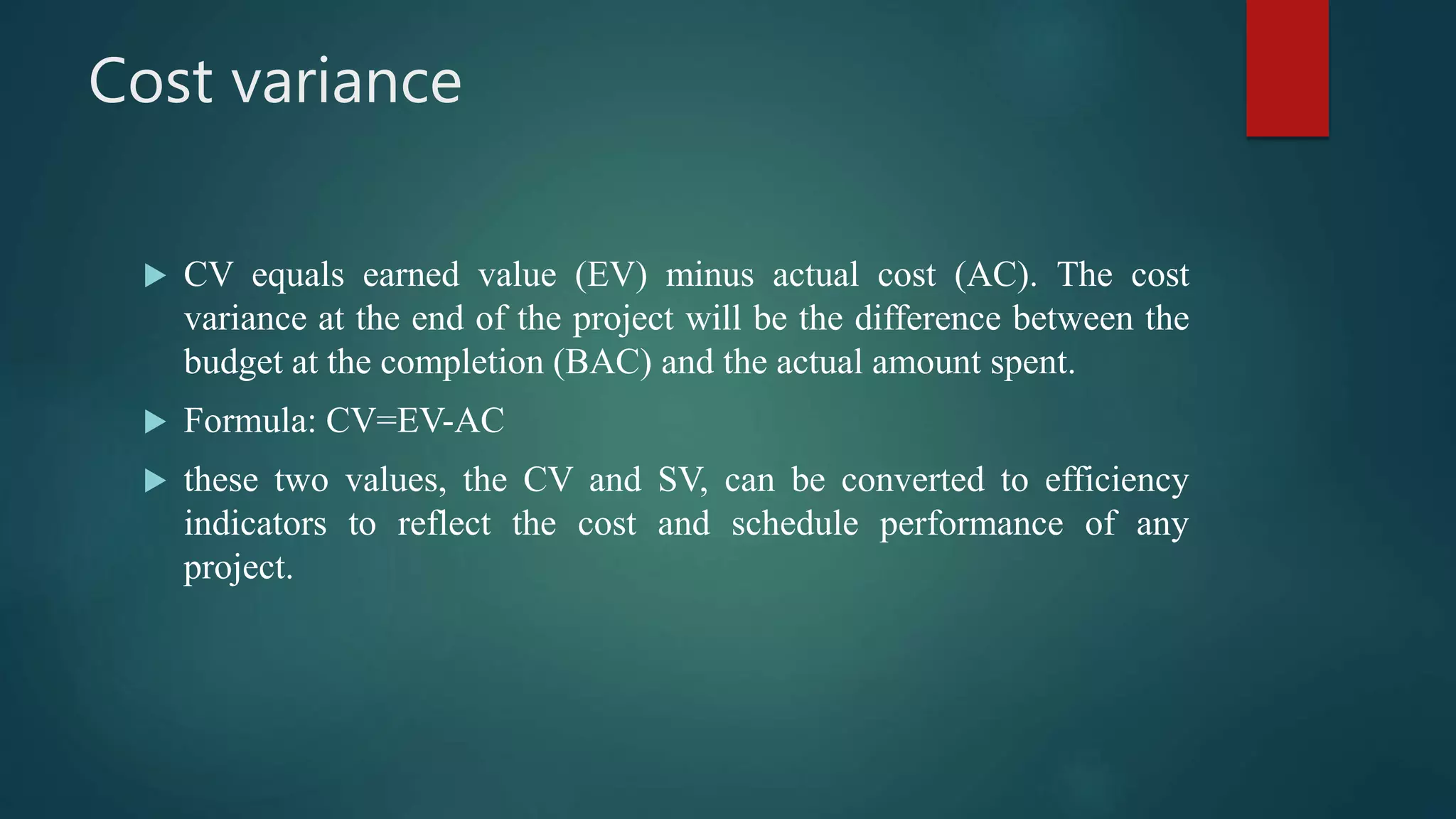

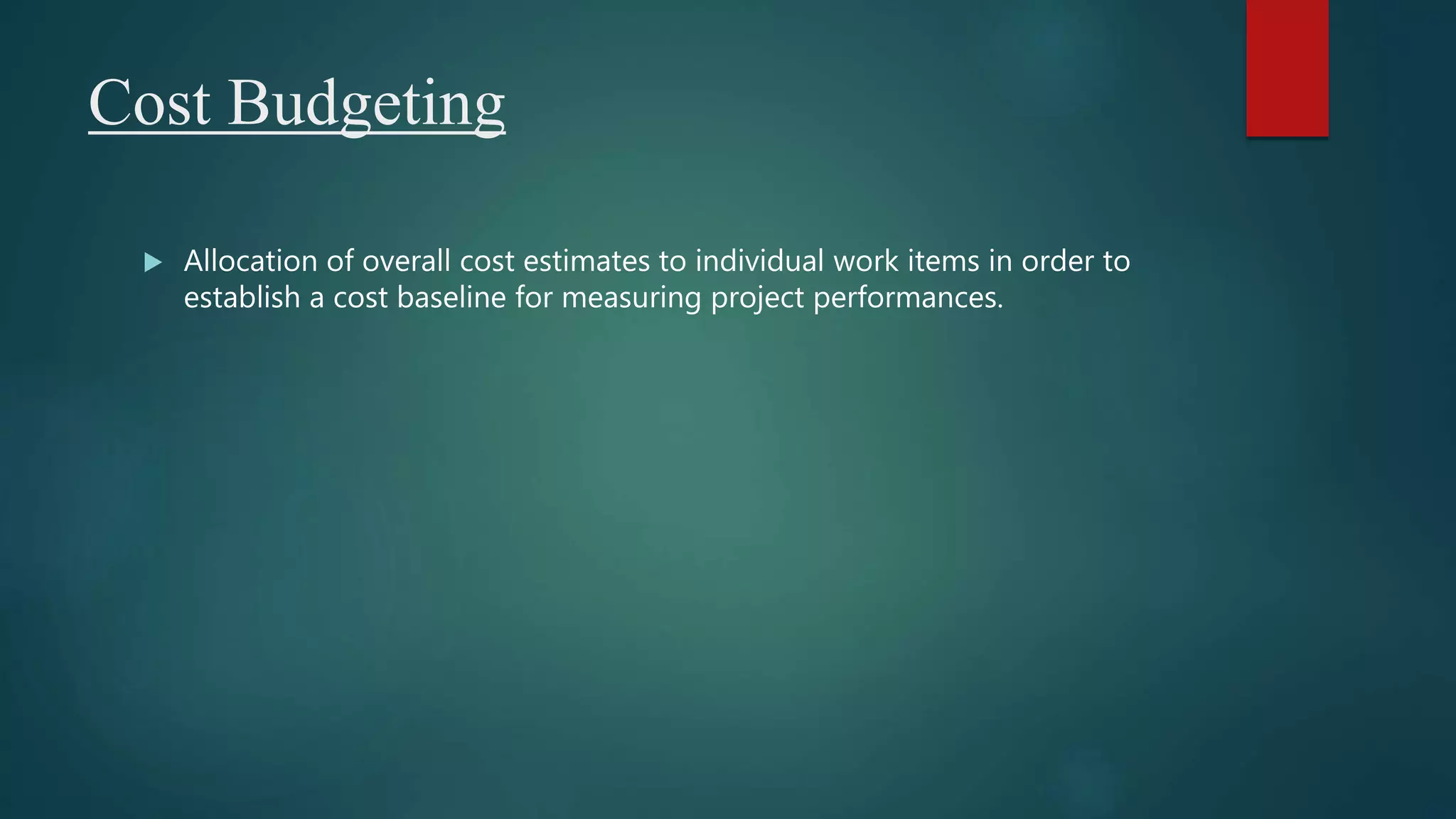

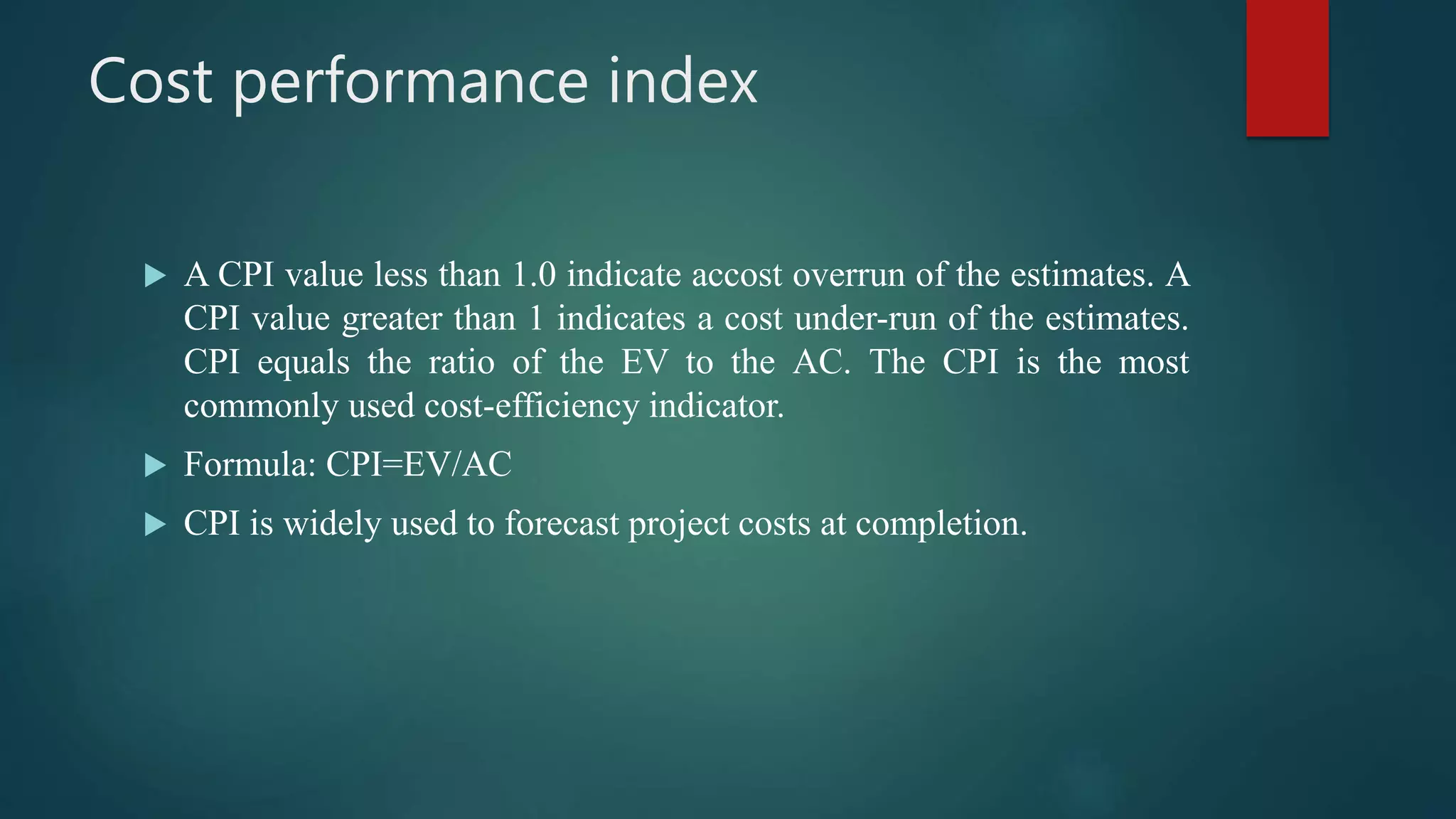

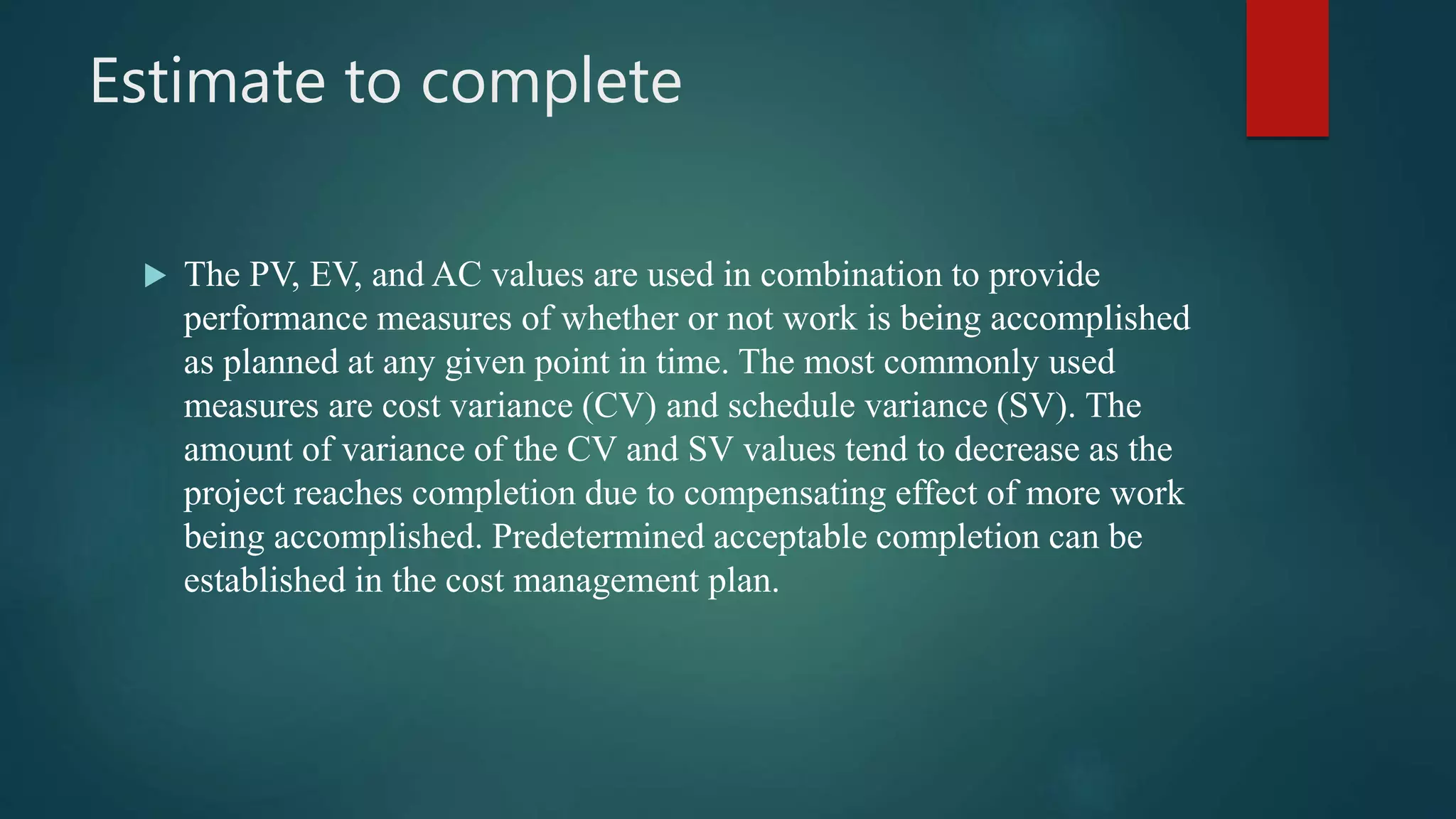

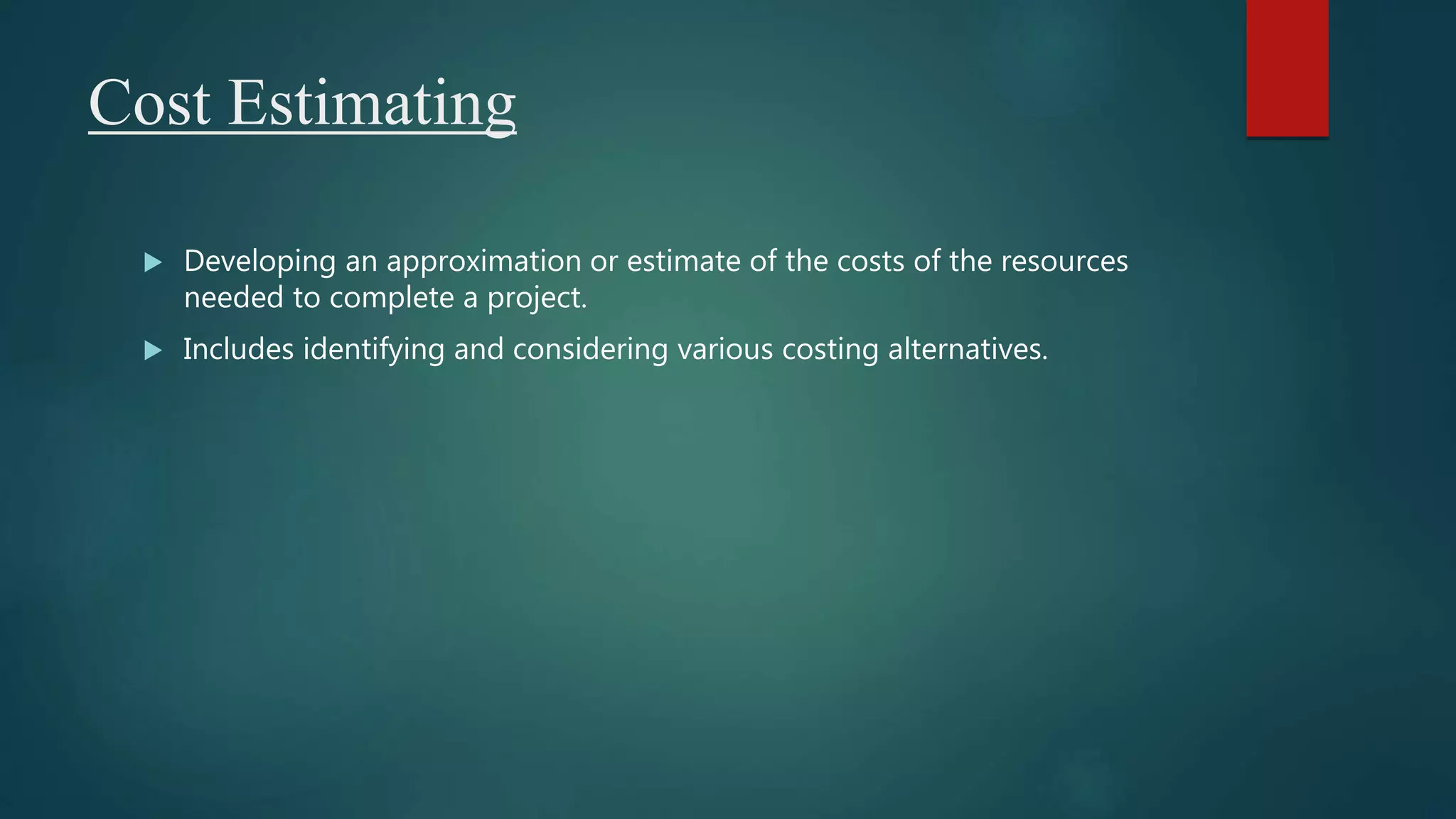

This document discusses project cost management and control. It describes cost estimating, cost budgeting, and cost control as the three factors of project cost management. It defines key terms like planned value, earned value, and actual cost used in earned value management. Earned value management compares planned work to actual work completed and actual costs to measure cost and schedule performance. The document also discusses tools for cost control like estimate to complete, forecasting, cost variance, and cost performance index.
