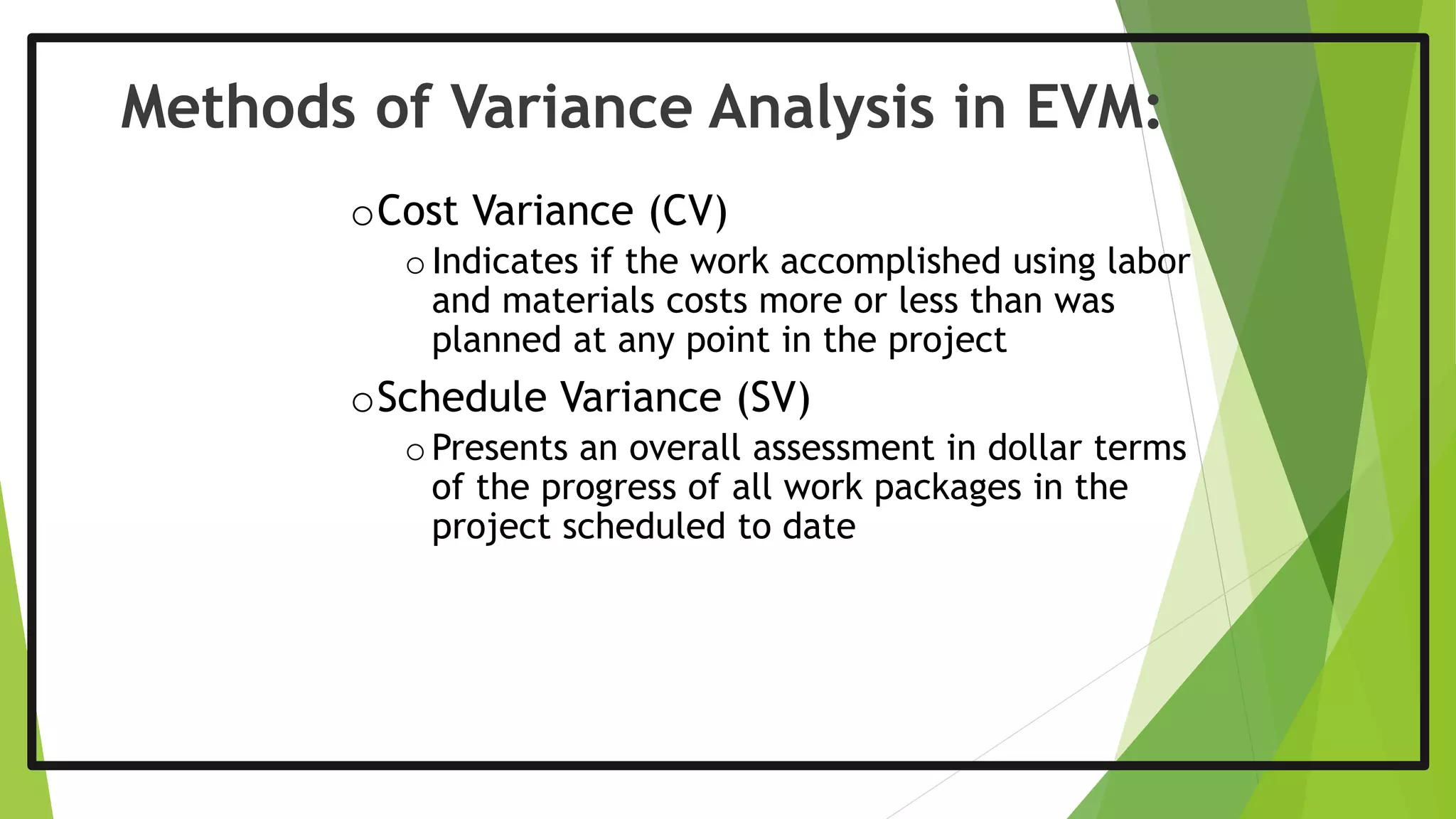

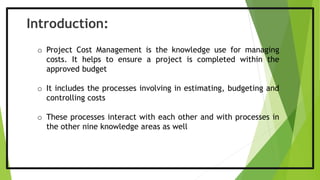

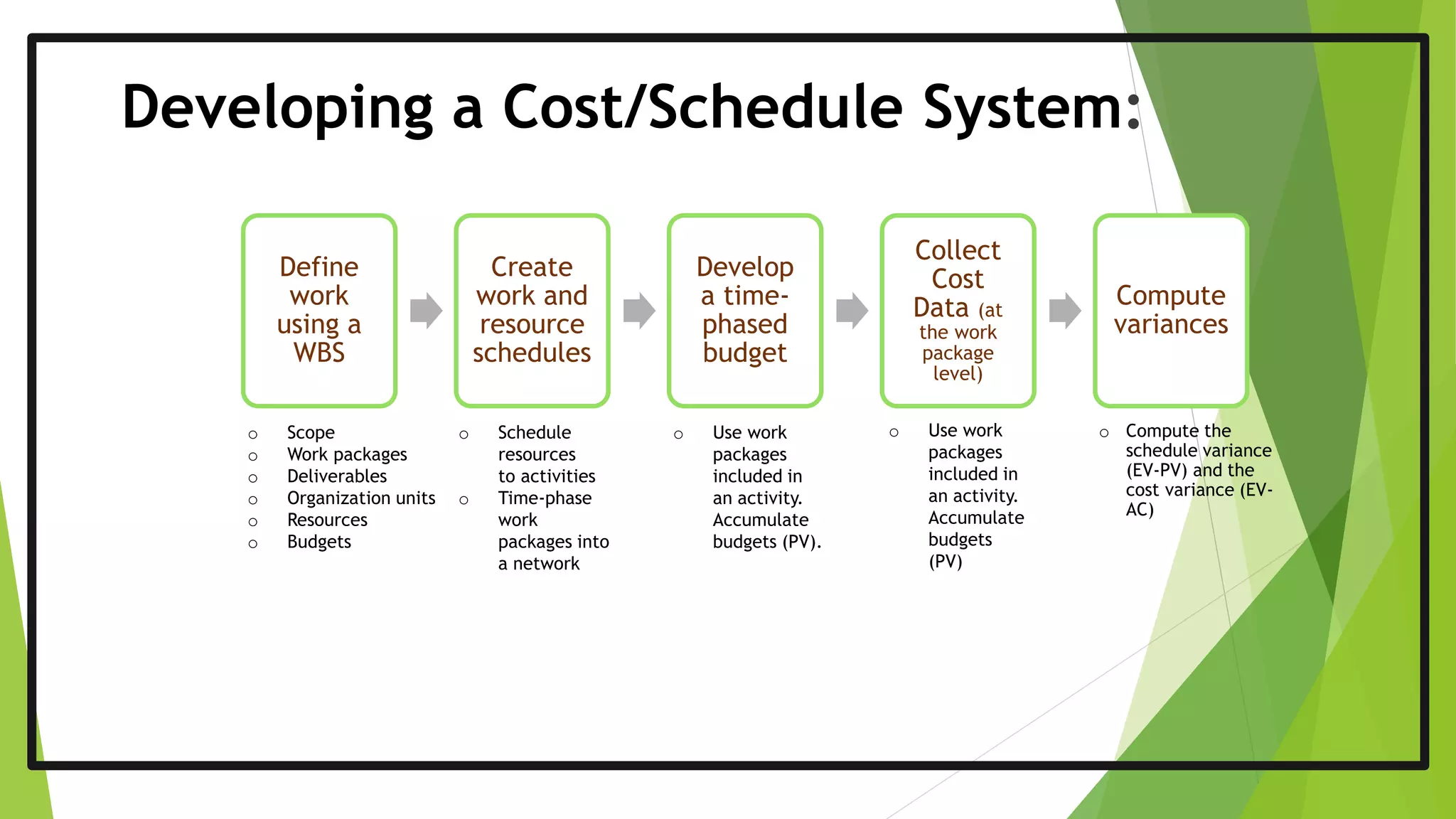

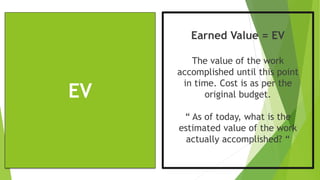

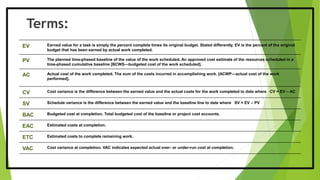

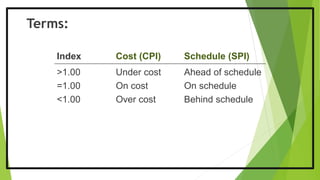

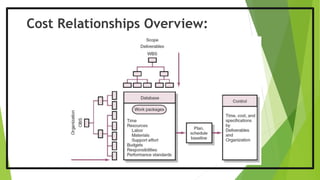

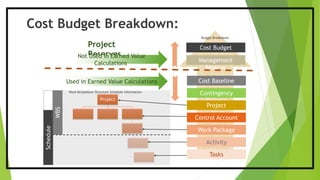

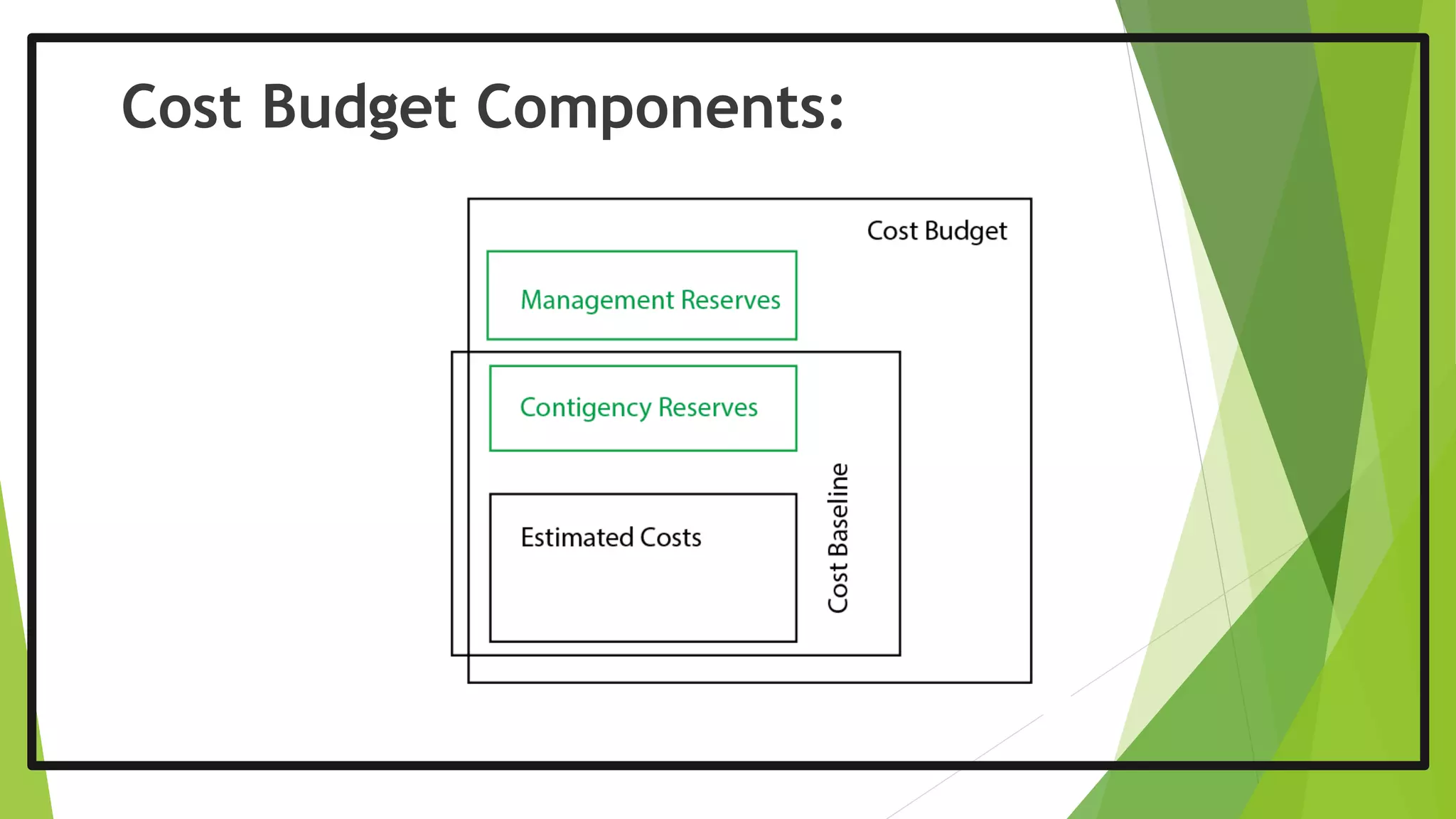

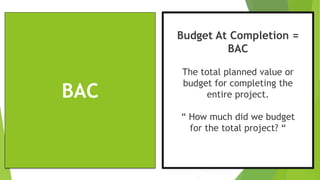

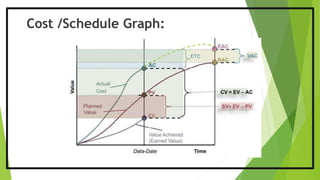

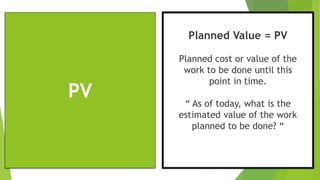

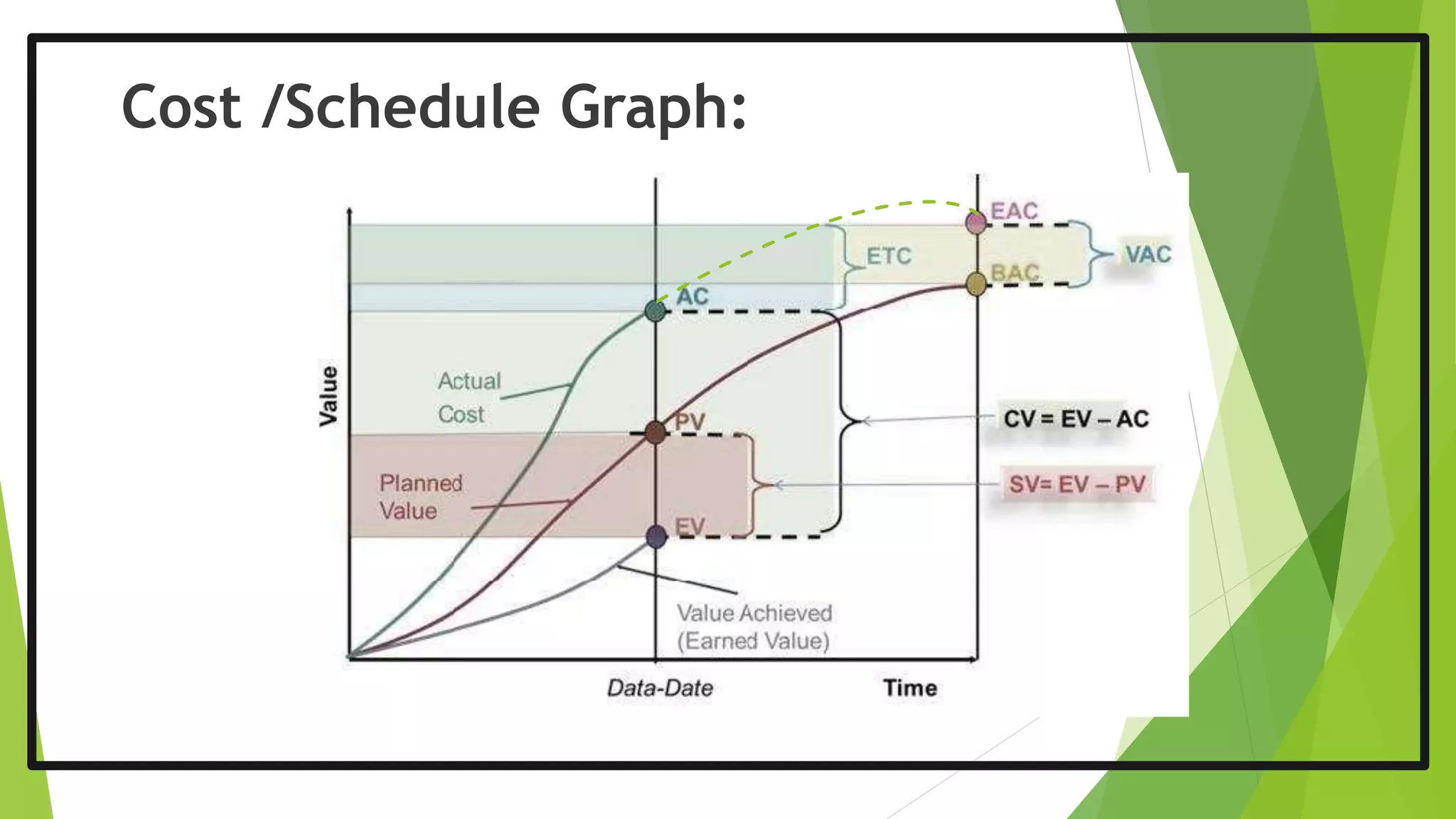

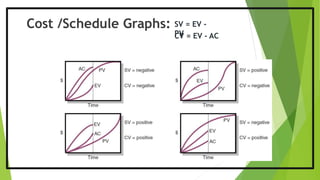

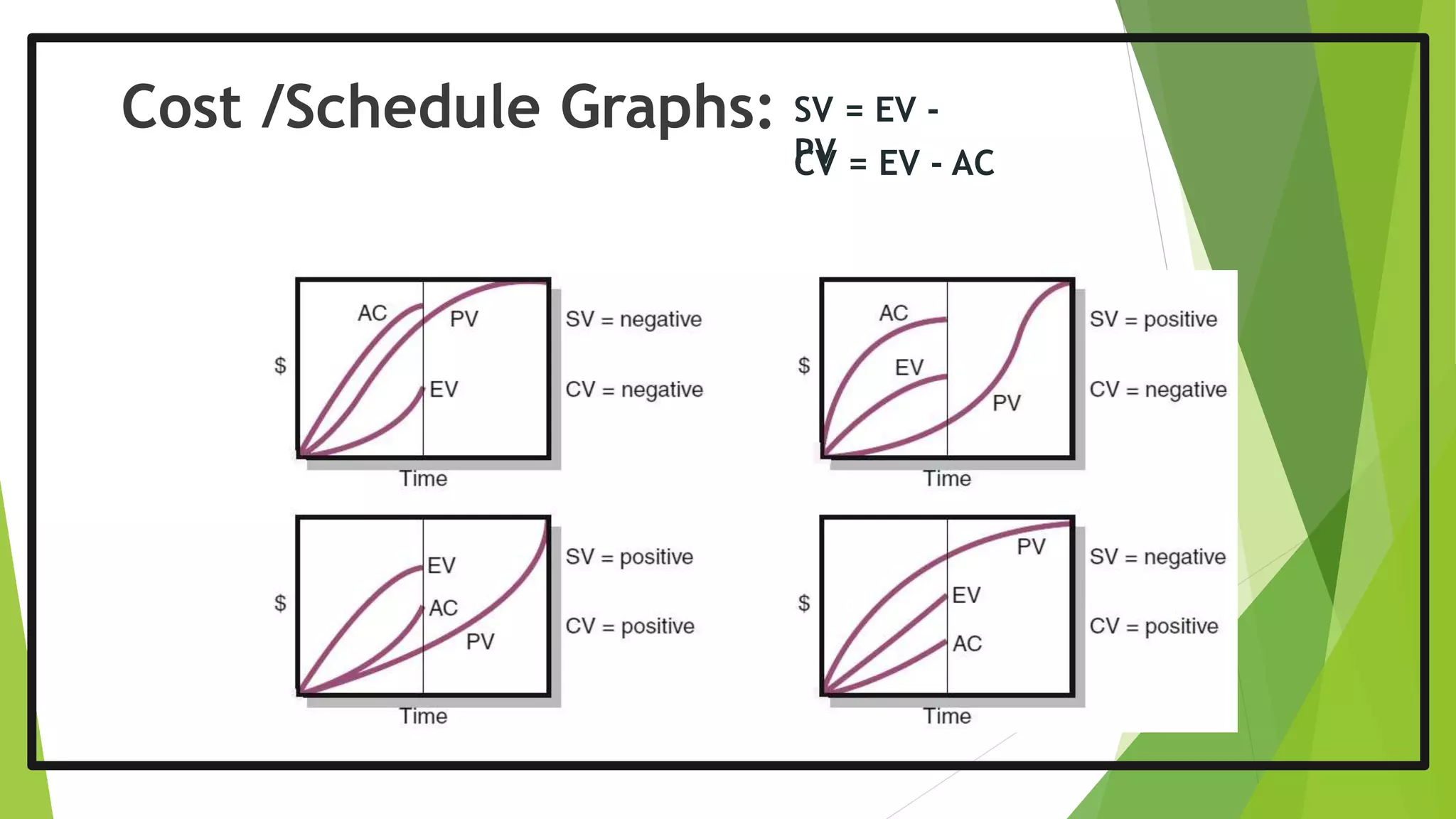

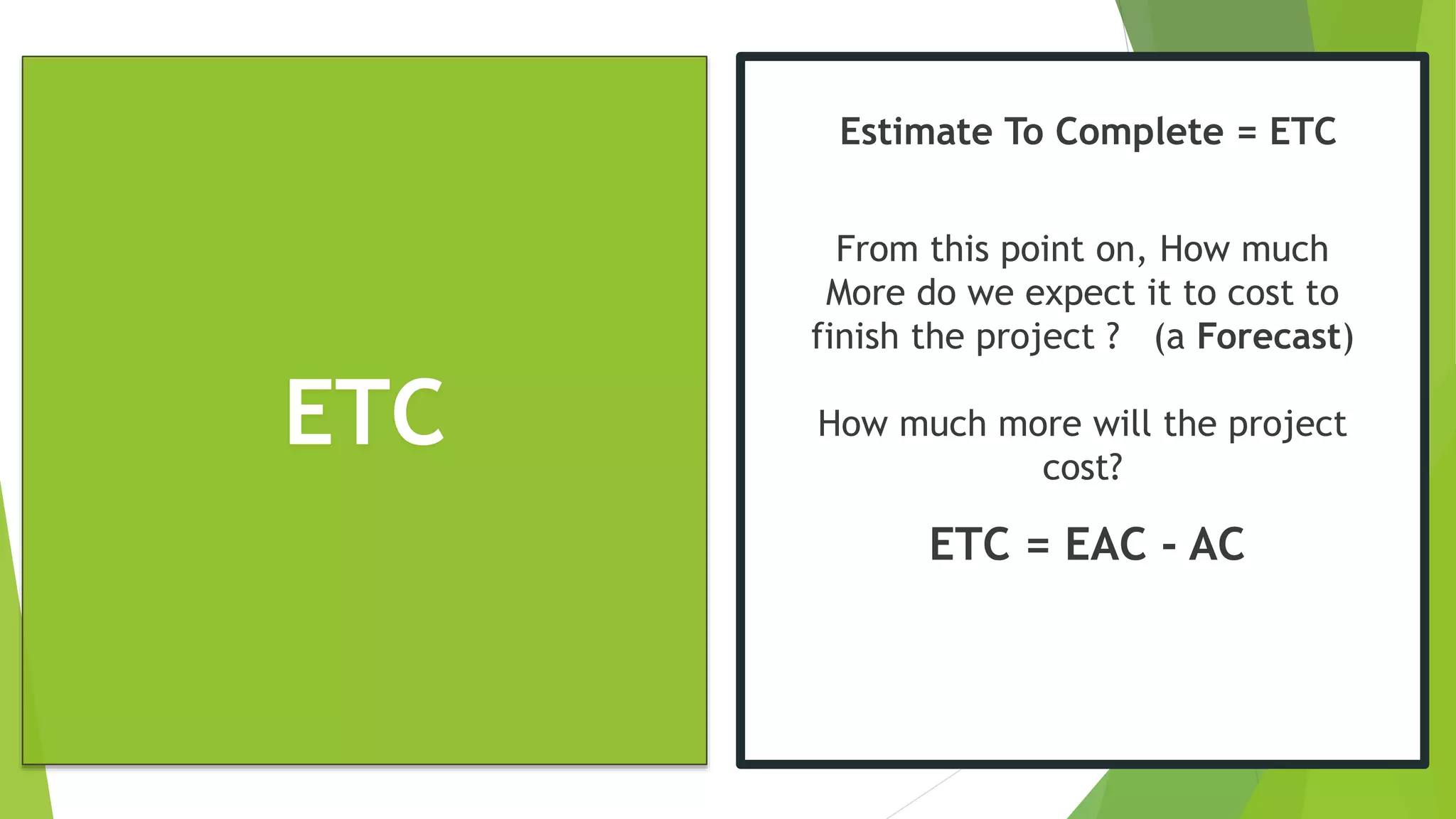

This document provides an overview of project cost management processes including developing cost baselines, earned value management, and variance analysis. It defines key terms like planned value, earned value, actual costs, cost variance, and schedule variance. Cost baselines include time-phased budgets for planned costs. Earned value management compares earned value to planned value and actual costs to calculate cost and schedule performance using indices like CPI, SPI, and variance. Variance analysis is used to track project performance and forecast final costs.
