SlideShare a Scribd company logo
1 of 41
Download to read offline
Project Schedule Management
Dr. Huy Nguyen

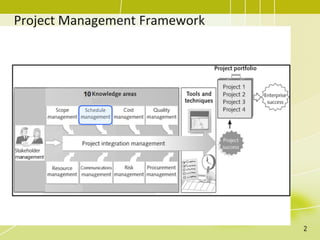

Project Management Framework
2

Process Groups & Knowledge Areas Mapping
Knowledge
Areas
Process Groups
Initiating Planning Executing Monitoring & Controlling Closing
Integration
Develop Project
Charter
Develop Project Management Plan
Direct and Manage Project Work
Manage Project Knowledge
Monitor and Control Project Work
Perform Integrated Change Control
Close Project or Phase
Scope
Plan Scope Management
Collect Requirements
Define Scope
Create WBS
Validate Scope
Control Scope
Schedule
Plan Schedule Management
Define Activities
Sequence Activities
Estimate Activity Durations
Develop Schedule
Control Schedule
Cost
Plan Cost Management
Estimate Costs
Determine Budget
Control Costs
Quality Plan Quality Management Manage Quality Control Quality
Resource
Plan Resource Management
Estimate Activity Resources
Acquire Resources
Develop Team
Manage Team
Control Resources
Communications Plan Communications Management Manage Communications Monitor Communications
Risk
Plan Risk Management
Identify Risks
Perform Qualitative Risk Analysis
Perform Quantitative Risk Analysis
Plan Risk Responses
Implement Risk Responses Monitor Risks
Procurement Plan Procurement Management Conduct Procurements Control Procurements
Stakeholder Identify Stakeholders Plan Stakeholder Engagement Manage Stakeholder Engagement Monitor Stakeholder Engagement
3
Project Schedule Management
Knowledge
Area
Process Groups
Initiating Planning Executing
Monitoring &
Controlling
Closing
Time
• Plan Schedule Management
• Define Activities
• Sequence Activities
• Estimate Activity Durations
• Develop Schedule
• Control Schedule
Enter phase/
Start project
Exit phase/
End project
Initiating
Processes
Closing
Processes
Planning
Processes
Executing
Processes
Monitoring &
Controlling Processes
4
Project Schedule Management
• The process required to manage timely completion of the project.
• Project time management starts with planning by the project management team
(not shown as a discrete process).
• In small projects, defining & sequencing activities, estimating activity resources
& durations, developing schedule model are viewed as a single process.
5

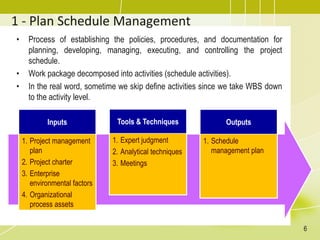

1 - Plan Schedule Management
• Process of establishing the policies, procedures, and documentation for
planning, developing, managing, executing, and controlling the project
schedule.
• Work package decomposed into activities (schedule activities).
• In the real word, sometime we skip define activities since we take WBS down
to the activity level.
Inputs
1. Project management
plan
2. Project charter
3. Enterprise
environmental factors
4. Organizational
process assets
Tools & Techniques
1. Expert judgment
2. Analytical techniques
3. Meetings
Outputs
1. Schedule
management plan
6

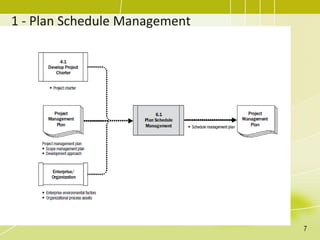

1 - Plan Schedule Management
7
Schedule Management Plan (Outputs)
• Project schedule model development;
• Level of accuracy;
• Units of measure;
• Organizational procedures links;
• Project schedule model maintenance;
• Control thresholds;
• Rules of performance measurement;
• Reporting formats;
• Process descriptions.
8

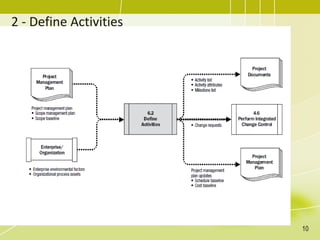

2 - Define Activities
• Process of identifying and documenting the specific actions to be performed to
produce the project deliverables.
Inputs
1. Schedule
management plan
2. Scope baseline
3. Enterprise
environmental factors
4. Organizational
process assets
Tools & Techniques
1. Decomposition
2. Rolling wave
planning
3. Expert judgment
Outputs
1. Activity list
2. Activity attributes
3. Milestone list
9
2 - Define Activities
10

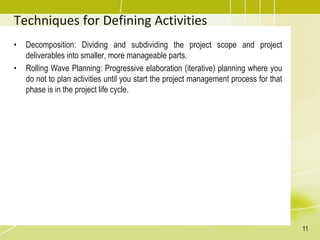

Techniques for Defining Activities
• Decomposition: Dividing and subdividing the project scope and project
deliverables into smaller, more manageable parts.
• Rolling Wave Planning: Progressive elaboration (iterative) planning where you
do not to plan activities until you start the project management process for that
phase is in the project life cycle.
11
Outputs for Defining Activities
• Activity Attributes:
– Use for schedule development, selecting, ordering, sorting the planned
schedule activities;
– Used to identify e.g. responsible person, place, level of effort (LOE),
apportioned effort (AE).
• Milestone list:
– Milestone is a significant point or event in the project:
• Not a work activity;
• Checkpoint to help control the project;
– Additional milestones can be added in Sequence Activities & Develop
Schedule process;
– The list can indicate the level of milestones (mandatory, optional, etc).
12

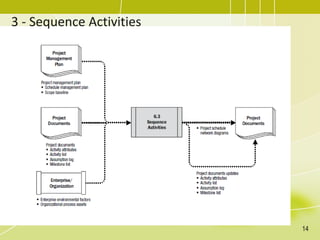

3 - Sequence Activities
• Process of identifying and documenting relationship among the project
activities.
Inputs
1. Schedule
management plan
2. Activity list
3. Activity attributes
4. Milestone list
5. Project scope
statement
6. Enterprise
environmental factors
7. Organizational
process assets
Tools & Techniques
1. Precedence
diagramming method
(PDM)
2. Dependency
determination
3. Leads and lags
Outputs
1. Project schedule
network diagrams
2. Project documents
updates
13
3 - Sequence Activities
14

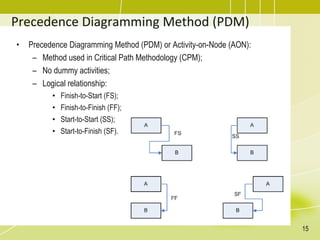

Precedence Diagramming Method (PDM)
• Precedence Diagramming Method (PDM) or Activity-on-Node (AON):
– Method used in Critical Path Methodology (CPM);
– No dummy activities;
– Logical relationship:
• Finish-to-Start (FS);
• Finish-to-Finish (FF);
• Start-to-Start (SS);
• Start-to-Finish (SF).
15
Precedence Diagramming Method (PDM) -
Applying Leads & Lags
• Use leads and lags to support realistic and achievable project schedule.
• Each activity is connected at least to one predecessor and one successor
except the start and the end.
• Leads:
– May be added to start an activity before the predecessor activity is
complete.
• Lags:
– Inserted waiting time between activities.
A B C
Predecessor Successor
A
B
A
B
16

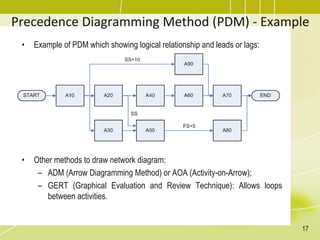

Precedence Diagramming Method (PDM) - Example
• Example of PDM which showing logical relationship and leads or lags:
• Other methods to draw network diagram:
– ADM (Arrow Diagramming Method) or AOA (Activity-on-Arrow);
– GERT (Graphical Evaluation and Review Technique): Allows loops
between activities.
17

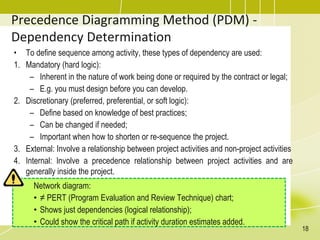

Precedence Diagramming Method (PDM) -
Dependency Determination
• To define sequence among activity, these types of dependency are used:
1. Mandatory (hard logic):
– Inherent in the nature of work being done or required by the contract or legal;
– E.g. you must design before you can develop.
2. Discretionary (preferred, preferential, or soft logic):
– Define based on knowledge of best practices;
– Can be changed if needed;
– Important when how to shorten or re-sequence the project.
3. External: Involve a relationship between project activities and non-project activities
4. Internal: Involve a precedence relationship between project activities and are
generally inside the project.
Network diagram:
• ≠ PERT (Program Evaluation and Review Technique) chart;
• Shows just dependencies (logical relationship);
• Could show the critical path if activity duration estimates added.
18

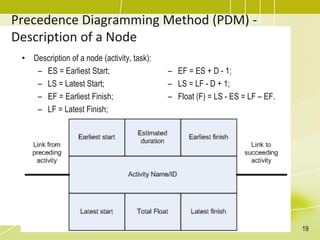

Precedence Diagramming Method (PDM) -
Description of a Node
• Description of a node (activity, task):
– ES = Earliest Start;
– LS = Latest Start;
– EF = Earliest Finish;
– LF = Latest Finish;
– EF = ES + D - 1;
– LS = LF - D + 1;
– Float (F) = LS - ES = LF – EF.
19

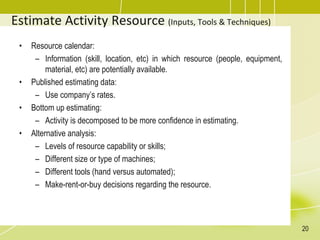

Estimate Activity Resource (Inputs, Tools & Techniques)
• Resource calendar:
– Information (skill, location, etc) in which resource (people, equipment,
material, etc) are potentially available.
• Published estimating data:
– Use company’s rates.
• Bottom up estimating:
– Activity is decomposed to be more confidence in estimating.
• Alternative analysis:
– Levels of resource capability or skills;
– Different size or type of machines;
– Different tools (hand versus automated);
– Make-rent-or-buy decisions regarding the resource.
20

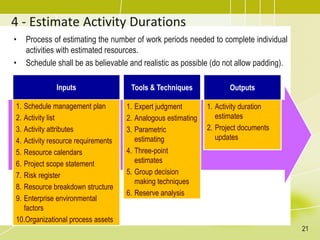

4 - Estimate Activity Durations
• Process of estimating the number of work periods needed to complete individual
activities with estimated resources.
• Schedule shall be as believable and realistic as possible (do not allow padding).
Inputs
1. Schedule management plan
2. Activity list
3. Activity attributes
4. Activity resource requirements
5. Resource calendars
6. Project scope statement
7. Risk register
8. Resource breakdown structure
9. Enterprise environmental
factors
10.Organizational process assets
Tools & Techniques
1. Expert judgment
2. Analogous estimating
3. Parametric
estimating
4. Three-point
estimates
5. Group decision
making techniques
6. Reserve analysis
Outputs
1. Activity duration
estimates
2. Project documents
updates
21

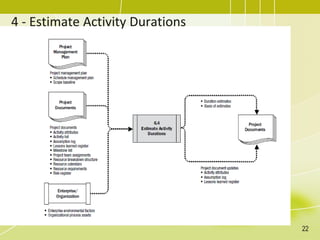

4 - Estimate Activity Durations
22

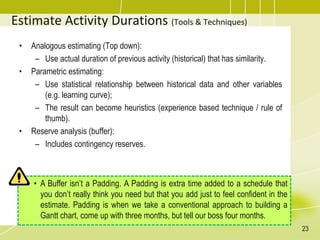

Estimate Activity Durations (Tools & Techniques)
• Analogous estimating (Top down):
– Use actual duration of previous activity (historical) that has similarity.
• Parametric estimating:
– Use statistical relationship between historical data and other variables
(e.g. learning curve);
– The result can become heuristics (experience based technique / rule of
thumb).
• Reserve analysis (buffer):
– Includes contingency reserves.
• A Buffer isn’t a Padding. A Padding is extra time added to a schedule that
you don’t really think you need but that you add just to feel confident in the
estimate. Padding is when we take a conventional approach to building a
Gantt chart, come up with three months, but tell our boss four months.
23

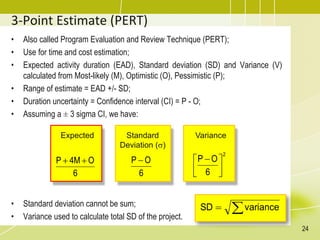

• Also called Program Evaluation and Review Technique (PERT);
• Use for time and cost estimation;
• Expected activity duration (EAD), Standard deviation (SD) and Variance (V)
calculated from Most-likely (M), Optimistic (O), Pessimistic (P);
• Range of estimate = EAD +/- SD;
• Duration uncertainty = Confidence interval (CI) = P - O;
• Assuming a ± 3 sigma CI, we have:
• Standard deviation cannot be sum;
• Variance used to calculate total SD of the project.
3-Point Estimate (PERT)
Expected
6
Ο
4Μ
P 

Standard
Deviation ()
6
Ο
P 
Variance
2
6
Ο
P





 

 variance
SD
24

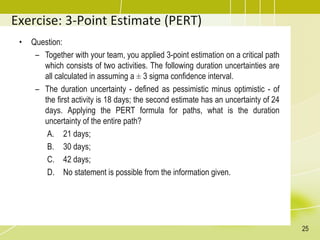

Exercise: 3-Point Estimate (PERT)
• Question:
– Together with your team, you applied 3-point estimation on a critical path
which consists of two activities. The following duration uncertainties are
all calculated in assuming a ± 3 sigma confidence interval.
– The duration uncertainty - defined as pessimistic minus optimistic - of
the first activity is 18 days; the second estimate has an uncertainty of 24
days. Applying the PERT formula for paths, what is the duration
uncertainty of the entire path?
A. 21 days;
B. 30 days;
C. 42 days;
D. No statement is possible from the information given.
25

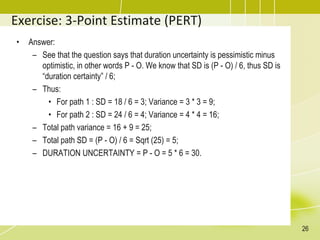

Exercise: 3-Point Estimate (PERT)
• Answer:
– See that the question says that duration uncertainty is pessimistic minus
optimistic, in other words P - O. We know that SD is (P - O) / 6, thus SD is
“duration certainty” / 6;
– Thus:
• For path 1 : SD = 18 / 6 = 3; Variance = 3 * 3 = 9;
• For path 2 : SD = 24 / 6 = 4; Variance = 4 * 4 = 16;
– Total path variance = 16 + 9 = 25;
– Total path SD = (P - O) / 6 = Sqrt (25) = 5;
– DURATION UNCERTAINTY = P - O = 5 * 6 = 30.
26

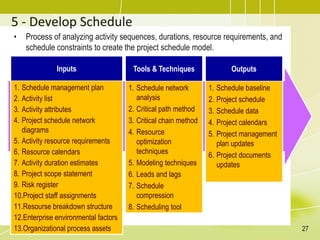

5 - Develop Schedule
• Process of analyzing activity sequences, durations, resource requirements, and
schedule constraints to create the project schedule model.
Inputs
1. Schedule management plan
2. Activity list
3. Activity attributes
4. Project schedule network
diagrams
5. Activity resource requirements
6. Resource calendars
7. Activity duration estimates
8. Project scope statement
9. Risk register
10.Project staff assignments
11.Resourse breakdown structure
12.Enterprise environmental factors
13.Organizational process assets
Tools & Techniques
1. Schedule network
analysis
2. Critical path method
3. Critical chain method
4. Resource
optimization
techniques
5. Modeling techniques
6. Leads and lags
7. Schedule
compression
8. Scheduling tool
Outputs
1. Schedule baseline
2. Project schedule
3. Schedule data
4. Project calendars
5. Project management
plan updates
6. Project documents
updates
27
5 - Develop Schedule
28

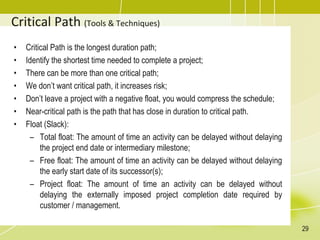

Critical Path (Tools & Techniques)
• Critical Path is the longest duration path;
• Identify the shortest time needed to complete a project;
• There can be more than one critical path;
• We don’t want critical path, it increases risk;
• Don’t leave a project with a negative float, you would compress the schedule;
• Near-critical path is the path that has close in duration to critical path.
• Float (Slack):
– Total float: The amount of time an activity can be delayed without delaying
the project end date or intermediary milestone;
– Free float: The amount of time an activity can be delayed without delaying
the early start date of its successor(s);
– Project float: The amount of time an activity can be delayed without
delaying the externally imposed project completion date required by
customer / management.
29

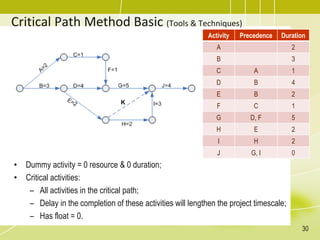

Critical Path Method Basic (Tools & Techniques)
Activity Precedence Duration
A 2
B 3
C A 1
D B 4
E B 2
F C 1
G D, F 5
H E 2
I H 2
J G, I 0
K
• Dummy activity = 0 resource & 0 duration;
• Critical activities:
– All activities in the critical path;
– Delay in the completion of these activities will lengthen the project timescale;
– Has float = 0.
30
Forward Pass
Backward Pass
ID
Critical Path using PDM (Tools & Techniques)
• Calculation:
– Forward Pass to calculte ES, EF:
• ES + D = ES (successor);
• Use highest value on join.
– Backward Pass to calculate LS, LF:
• LS - D (predecessor) = LS (predecessor);
• Use lowest value on join.
31
Exercise
Questions:
• What is the critical path?
• What is critical path duration?
• What is float (slack) duration of activity A30?
Answers:
• -
• -
• -
A60
A50
32

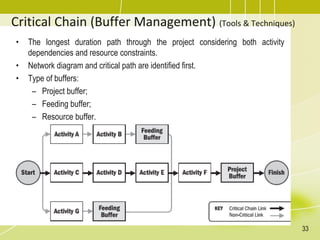

• The longest duration path through the project considering both activity
dependencies and resource constraints.
• Network diagram and critical path are identified first.
• Type of buffers:
– Project buffer;
– Feeding buffer;
– Resource buffer.
Critical Chain (Buffer Management) (Tools & Techniques)
33
• Resource leveling:
– Start and finish dates are adjusted based on resource constraints with the
goal of balancing demand for resources with the available supply;
– Can be used when shared or critically required resources are only
available at certain times, or in limited quantities, or over-allocated.
• Resource smoothing:
– Adjusts the activities of a schedule model such that the requirements for
resources on the project do not exceed certain predefined resource limits;
– The critical path is not changed and the completion date may not be
delayed.
Resource Optimization Techniques (Tools & Techniques)
34
• Analysis on effect of changes on a particular thing (assumption) on the project
which make activity duration change.
• What-if scenario analysis:
– Evaluate scenarios in order to predict their effect, positively or negatively,
on project objectives;
– “What if the situation ‘Y’ is represented by the scenario ‘X’ happens?”
• Monte Carlo simulation:
– Used when there is possibility that the critical path will be different for a
given set of project conditions;
– Using probability distribution for each activity or group of activities;
– Using computer software;
– Using three-point estimates and network diagram;
– Help deal with “path convergence”:
• Multiple paths converge into one or more activities (but adding risk).
Modeling Techniques (Tools & Techniques)
35
• Fast Tracking:
– Performing critical path activities in parallel;
– Usually increase risk and requires more attention to communication;
– May need a rework;
– E.g. design is half finished and start coding.
• Crashing:
– Analyze cost and schedule trade-offs;
– Determine most compression for least cost;
– Crash the tasks that cost the least first, focusing on minimizing project
cost;
– Always results in increased cost.
Schedule Compression (Tools & Techniques)
36
Project Schedule (Outputs)
• Schedule can be shown with or without dependencies (logical relationship).
• Presented as:
– Summary form e.g. Master schedule, Milestone schedule;
– Detailed form.
• Format:
– Network diagram;
– Milestone chart;
– Bar chart (Gantt chart).
37
Schedule Data (Outputs)
• Includes at least:
– Schedule milestone;
– Schedule activities;
– Activity attributes;
– Assumptions & Constraints.
• Additional information can be added, such as:
– Resource histograms;
– Cash-flow projections;
– Order & delivery schedules;
– Alternative schedules.
38

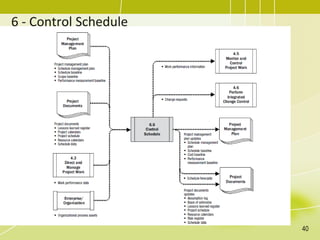

6 - Control Schedule
• Process of monitoring the status of project activities to update project
progress and manage changes to the schedule baseline to achieve the plan.
Inputs
1. Project management
plan
2. Project schedule
3. Work performance
data
4. Project calendars
5. Schedule data
6. Organizational
process assets
Tools & Techniques
1. Performance reviews
2. Project management
Software
3. Resource
optimization
techniques
4. Modeling techniques
5. Leads & lags
6. Schedule
compression
7. Scheduling tool
Outputs
1. Work performance
information
2. Schedule forecasts
3. Change requests
4. Project management
plan updates
5. Project documents
updates
6. Organizational
process assets
updates
39

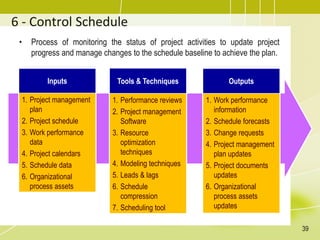

6 - Control Schedule
40
Thank You
Next topic:
Project Cost Management
41

More Related Content

What's hot

PMP NOTES Based on PMBOK Guide 5th Edition and updated PMP syllabus after 11 ...
PMP NOTES Based on PMBOK Guide 5th Edition and updated PMP syllabus after 11 ...PMP NOTES Based on PMBOK Guide 5th Edition and updated PMP syllabus after 11 ...
PMP NOTES Based on PMBOK Guide 5th Edition and updated PMP syllabus after 11 ...JustAcademy

PMP PMBOK 5th Ch 11 Project Risk Management
PMP PMBOK 5th Ch 11 Project Risk ManagementPMP PMBOK 5th Ch 11 Project Risk Management
PMP PMBOK 5th Ch 11 Project Risk ManagementAbdullah Ahmed, PMP, RMP

Project Management Software
Project Management SoftwareProject Management Software
Project Management SoftwareMartin Sillaots

IT PMO Charter (Linkedin)
IT PMO Charter (Linkedin)IT PMO Charter (Linkedin)
IT PMO Charter (Linkedin)jimmcdonaldpmp

Project scope management
Project scope managementProject scope management
Project scope managementAnit Roy

Develop Project Management Plan Data Flow Diagram
Develop Project Management Plan Data Flow DiagramDevelop Project Management Plan Data Flow Diagram
Develop Project Management Plan Data Flow Diagramriosabel

Project scope management
Project scope managementProject scope management
Project scope managementDhani Ahmad

Setting up a Project Management Office (PMO)
Setting up a Project Management Office (PMO)Setting up a Project Management Office (PMO)
Setting up a Project Management Office (PMO)Hussain Bandukwala

Discover the right tools for your Project Management Office (PMO)
Discover the right tools for your Project Management Office (PMO)Discover the right tools for your Project Management Office (PMO)
Discover the right tools for your Project Management Office (PMO)Hussain Bandukwala

TIME MANAGEMENT chapter(6), PMBOK5
TIME MANAGEMENT chapter(6), PMBOK5TIME MANAGEMENT chapter(6), PMBOK5
TIME MANAGEMENT chapter(6), PMBOK5Hisham Ali,PMP

Chap 5.3 define scope
Chap 5.3 define scopeChap 5.3 define scope
Chap 5.3 define scopeAnand Bobade

11.6 Implement Risk Responses
11.6 Implement Risk Responses11.6 Implement Risk Responses
11.6 Implement Risk ResponsesDavidMcLachlan1

PMP Chap 6 - Project Time management - Part1
PMP Chap 6 - Project Time management - Part1PMP Chap 6 - Project Time management - Part1
PMP Chap 6 - Project Time management - Part1Anand Bobade

PMO Charter Template
PMO Charter TemplatePMO Charter Template
PMO Charter TemplateDemand Metric

What's hot (20)

PMP NOTES Based on PMBOK Guide 5th Edition and updated PMP syllabus after 11 ...
PMP NOTES Based on PMBOK Guide 5th Edition and updated PMP syllabus after 11 ...PMP NOTES Based on PMBOK Guide 5th Edition and updated PMP syllabus after 11 ...
PMP NOTES Based on PMBOK Guide 5th Edition and updated PMP syllabus after 11 ...

Project management
Project managementProject management
Project management

PMP PMBOK 5th Ch 11 Project Risk Management
PMP PMBOK 5th Ch 11 Project Risk ManagementPMP PMBOK 5th Ch 11 Project Risk Management
PMP PMBOK 5th Ch 11 Project Risk Management

Project Management Software
Project Management SoftwareProject Management Software
Project Management Software

IT PMO Charter (Linkedin)
IT PMO Charter (Linkedin)IT PMO Charter (Linkedin)
IT PMO Charter (Linkedin)

02 project scope management
02 project scope management02 project scope management
02 project scope management

Project scope management
Project scope managementProject scope management
Project scope management

Develop Project Management Plan Data Flow Diagram
Develop Project Management Plan Data Flow DiagramDevelop Project Management Plan Data Flow Diagram
Develop Project Management Plan Data Flow Diagram

Project scope management
Project scope managementProject scope management
Project scope management

Setting up a Project Management Office (PMO)
Setting up a Project Management Office (PMO)Setting up a Project Management Office (PMO)
Setting up a Project Management Office (PMO)

1. project integration management
1. project integration management1. project integration management
1. project integration management

Discover the right tools for your Project Management Office (PMO)
Discover the right tools for your Project Management Office (PMO)Discover the right tools for your Project Management Office (PMO)
Discover the right tools for your Project Management Office (PMO)

Project Planning Scheduling
Project Planning SchedulingProject Planning Scheduling
Project Planning Scheduling

TIME MANAGEMENT chapter(6), PMBOK5
TIME MANAGEMENT chapter(6), PMBOK5TIME MANAGEMENT chapter(6), PMBOK5
TIME MANAGEMENT chapter(6), PMBOK5

Chap 5.3 define scope
Chap 5.3 define scopeChap 5.3 define scope
Chap 5.3 define scope

Self test engine PSP-PMI-SP
Self test engine PSP-PMI-SPSelf test engine PSP-PMI-SP
Self test engine PSP-PMI-SP

PMBOK PROCESS FLOW.pdf
PMBOK PROCESS FLOW.pdfPMBOK PROCESS FLOW.pdf
PMBOK PROCESS FLOW.pdf

11.6 Implement Risk Responses
11.6 Implement Risk Responses11.6 Implement Risk Responses
11.6 Implement Risk Responses

PMP Chap 6 - Project Time management - Part1
PMP Chap 6 - Project Time management - Part1PMP Chap 6 - Project Time management - Part1
PMP Chap 6 - Project Time management - Part1

PMO Charter Template
PMO Charter TemplatePMO Charter Template
PMO Charter Template

Similar to Topic 11 - Project Schedule Management.pdf

06 projecttimemanagement
06 projecttimemanagement06 projecttimemanagement
06 projecttimemanagementDhamo daran

Project time management
Project time managementProject time management
Project time managementImran Jamil

A brief on project time management
A brief on project time managementA brief on project time management
A brief on project time managementImran Jamil

Day 3 Schedule -walaa (3).pptx
Day 3 Schedule -walaa (3).pptxDay 3 Schedule -walaa (3).pptx
Day 3 Schedule -walaa (3).pptxMohanadRabea1

Time Management within IT Project Management
Time Management within IT Project ManagementTime Management within IT Project Management
Time Management within IT Project Managementrielaantonio

Pmbok 5th planning process group part two
Pmbok 5th planning process group part twoPmbok 5th planning process group part two
Pmbok 5th planning process group part twoHossam Maghrabi

Episode 23 : PROJECT TIME MANAGEMENT
Episode 23 : PROJECT TIME MANAGEMENTEpisode 23 : PROJECT TIME MANAGEMENT
Episode 23 : PROJECT TIME MANAGEMENTSAJJAD KHUDHUR ABBAS

Software Engineering (Project Scheduling)
Software Engineering (Project Scheduling)Software Engineering (Project Scheduling)
Software Engineering (Project Scheduling)ShudipPal

Project Schedule Management - PMBOK6
Project Schedule Management - PMBOK6Project Schedule Management - PMBOK6
Project Schedule Management - PMBOK6Agus Suhanto

Time management pressent
Time management pressentTime management pressent
Time management pressentiklil fairuz

3- Project Time Management.ppt
3- Project Time Management.ppt3- Project Time Management.ppt
3- Project Time Management.pptMohamadAGhareb

DISE - Introduction to Project Management
DISE - Introduction to Project ManagementDISE - Introduction to Project Management
DISE - Introduction to Project ManagementRasan Samarasinghe

Planning and Resourcing a Project
Planning and Resourcing a ProjectPlanning and Resourcing a Project
Planning and Resourcing a ProjectNishant Munjal

PMP-Schedule Management area
PMP-Schedule Management areaPMP-Schedule Management area
PMP-Schedule Management areaZaur Ahmadov, PMP

Similar to Topic 11 - Project Schedule Management.pdf (20)

06 projecttimemanagement
06 projecttimemanagement06 projecttimemanagement
06 projecttimemanagement

Project time management
Project time managementProject time management
Project time management

A brief on project time management
A brief on project time managementA brief on project time management
A brief on project time management

Day 3 Schedule -walaa (3).pptx
Day 3 Schedule -walaa (3).pptxDay 3 Schedule -walaa (3).pptx
Day 3 Schedule -walaa (3).pptx

4) PTM & PCM .pptx
4) PTM & PCM .pptx4) PTM & PCM .pptx
4) PTM & PCM .pptx

Time Management within IT Project Management
Time Management within IT Project ManagementTime Management within IT Project Management
Time Management within IT Project Management

Session 8 4th edition PMP
Session 8 4th edition PMPSession 8 4th edition PMP
Session 8 4th edition PMP

Pmbok 5th planning process group part two
Pmbok 5th planning process group part twoPmbok 5th planning process group part two
Pmbok 5th planning process group part two

Episode 23 : PROJECT TIME MANAGEMENT
Episode 23 : PROJECT TIME MANAGEMENTEpisode 23 : PROJECT TIME MANAGEMENT
Episode 23 : PROJECT TIME MANAGEMENT

Time management
Time managementTime management
Time management

Software Engineering (Project Scheduling)
Software Engineering (Project Scheduling)Software Engineering (Project Scheduling)
Software Engineering (Project Scheduling)

Project Schedule Management - PMBOK6
Project Schedule Management - PMBOK6Project Schedule Management - PMBOK6
Project Schedule Management - PMBOK6

Time management pressent
Time management pressentTime management pressent
Time management pressent

3- Project Time Management.ppt
3- Project Time Management.ppt3- Project Time Management.ppt
3- Project Time Management.ppt

programmed evaluation and review technique,
programmed evaluation and review technique,programmed evaluation and review technique,
programmed evaluation and review technique,

DISE - Introduction to Project Management
DISE - Introduction to Project ManagementDISE - Introduction to Project Management
DISE - Introduction to Project Management

Session 5 4th edition PMP
Session 5 4th edition PMPSession 5 4th edition PMP
Session 5 4th edition PMP

Project scheduling
Project schedulingProject scheduling
Project scheduling

Planning and Resourcing a Project
Planning and Resourcing a ProjectPlanning and Resourcing a Project
Planning and Resourcing a Project

PMP-Schedule Management area
PMP-Schedule Management areaPMP-Schedule Management area
PMP-Schedule Management area

More from HuyNguyen657394

Topic 15 - Leadership in Project Management.pdf
Topic 15 - Leadership in Project Management.pdfTopic 15 - Leadership in Project Management.pdf
Topic 15 - Leadership in Project Management.pdfHuyNguyen657394

Topic 14 - Project Team Management.pdf
Topic 14 - Project Team Management.pdfTopic 14 - Project Team Management.pdf
Topic 14 - Project Team Management.pdfHuyNguyen657394

Tips - IT Project Management.pdf
Tips - IT Project Management.pdfTips - IT Project Management.pdf
Tips - IT Project Management.pdfHuyNguyen657394

Topic 13 - Project Resource Management.pdf
Topic 13 - Project Resource Management.pdfTopic 13 - Project Resource Management.pdf
Topic 13 - Project Resource Management.pdfHuyNguyen657394

Topic 12 - Project Cost Management.pdf
Topic 12 - Project Cost Management.pdfTopic 12 - Project Cost Management.pdf
Topic 12 - Project Cost Management.pdfHuyNguyen657394

Topic 10 - Project Performance Management.pdf
Topic 10 - Project Performance Management.pdfTopic 10 - Project Performance Management.pdf
Topic 10 - Project Performance Management.pdfHuyNguyen657394

Topic 9 - Project Stakeholder Management.pdf
Topic 9 - Project Stakeholder Management.pdfTopic 9 - Project Stakeholder Management.pdf
Topic 9 - Project Stakeholder Management.pdfHuyNguyen657394

Topic 8 - Project Quality Management.pdf
Topic 8 - Project Quality Management.pdfTopic 8 - Project Quality Management.pdf
Topic 8 - Project Quality Management.pdfHuyNguyen657394

Topic 7 - Project Scope Management.pdf
Topic 7 - Project Scope Management.pdfTopic 7 - Project Scope Management.pdf
Topic 7 - Project Scope Management.pdfHuyNguyen657394

Topic 6 - Project Integration Management.pdf
Topic 6 - Project Integration Management.pdfTopic 6 - Project Integration Management.pdf
Topic 6 - Project Integration Management.pdfHuyNguyen657394

Topic 5 - Project Planning.pdf
Topic 5 - Project Planning.pdfTopic 5 - Project Planning.pdf
Topic 5 - Project Planning.pdfHuyNguyen657394

Topic 4 - Project Management Process.pdf
Topic 4 - Project Management Process.pdfTopic 4 - Project Management Process.pdf
Topic 4 - Project Management Process.pdfHuyNguyen657394

Topic 3 - Project Selection & Portfolio Management.pdf
Topic 3 - Project Selection & Portfolio Management.pdfTopic 3 - Project Selection & Portfolio Management.pdf
Topic 3 - Project Selection & Portfolio Management.pdfHuyNguyen657394

Topic 2 - Project Life Cycle and Project Management Organization.pdf
Topic 2 - Project Life Cycle and Project Management Organization.pdfTopic 2 - Project Life Cycle and Project Management Organization.pdf
Topic 2 - Project Life Cycle and Project Management Organization.pdfHuyNguyen657394

Topic 1 - Introduction of Project Management.pdf
Topic 1 - Introduction of Project Management.pdfTopic 1 - Introduction of Project Management.pdf
Topic 1 - Introduction of Project Management.pdfHuyNguyen657394

Topic 0 - General Information.pdf
Topic 0 - General Information.pdfTopic 0 - General Information.pdf
Topic 0 - General Information.pdfHuyNguyen657394

Topic 0 - General Information New.pdf
Topic 0 - General Information New.pdfTopic 0 - General Information New.pdf
Topic 0 - General Information New.pdfHuyNguyen657394

Nhan thuc ve chuyen doi so.pdf
Nhan thuc ve chuyen doi so.pdfNhan thuc ve chuyen doi so.pdf
Nhan thuc ve chuyen doi so.pdfHuyNguyen657394

More from HuyNguyen657394 (18)

Topic 15 - Leadership in Project Management.pdf
Topic 15 - Leadership in Project Management.pdfTopic 15 - Leadership in Project Management.pdf
Topic 15 - Leadership in Project Management.pdf

Topic 14 - Project Team Management.pdf
Topic 14 - Project Team Management.pdfTopic 14 - Project Team Management.pdf
Topic 14 - Project Team Management.pdf

Tips - IT Project Management.pdf
Tips - IT Project Management.pdfTips - IT Project Management.pdf
Tips - IT Project Management.pdf

Topic 13 - Project Resource Management.pdf
Topic 13 - Project Resource Management.pdfTopic 13 - Project Resource Management.pdf
Topic 13 - Project Resource Management.pdf

Topic 12 - Project Cost Management.pdf
Topic 12 - Project Cost Management.pdfTopic 12 - Project Cost Management.pdf
Topic 12 - Project Cost Management.pdf

Topic 10 - Project Performance Management.pdf
Topic 10 - Project Performance Management.pdfTopic 10 - Project Performance Management.pdf
Topic 10 - Project Performance Management.pdf

Topic 9 - Project Stakeholder Management.pdf
Topic 9 - Project Stakeholder Management.pdfTopic 9 - Project Stakeholder Management.pdf
Topic 9 - Project Stakeholder Management.pdf

Topic 8 - Project Quality Management.pdf
Topic 8 - Project Quality Management.pdfTopic 8 - Project Quality Management.pdf
Topic 8 - Project Quality Management.pdf

Topic 7 - Project Scope Management.pdf
Topic 7 - Project Scope Management.pdfTopic 7 - Project Scope Management.pdf
Topic 7 - Project Scope Management.pdf

Topic 6 - Project Integration Management.pdf
Topic 6 - Project Integration Management.pdfTopic 6 - Project Integration Management.pdf
Topic 6 - Project Integration Management.pdf

Topic 5 - Project Planning.pdf
Topic 5 - Project Planning.pdfTopic 5 - Project Planning.pdf
Topic 5 - Project Planning.pdf

Topic 4 - Project Management Process.pdf
Topic 4 - Project Management Process.pdfTopic 4 - Project Management Process.pdf
Topic 4 - Project Management Process.pdf

Topic 3 - Project Selection & Portfolio Management.pdf
Topic 3 - Project Selection & Portfolio Management.pdfTopic 3 - Project Selection & Portfolio Management.pdf
Topic 3 - Project Selection & Portfolio Management.pdf

Topic 2 - Project Life Cycle and Project Management Organization.pdf
Topic 2 - Project Life Cycle and Project Management Organization.pdfTopic 2 - Project Life Cycle and Project Management Organization.pdf
Topic 2 - Project Life Cycle and Project Management Organization.pdf

Topic 1 - Introduction of Project Management.pdf
Topic 1 - Introduction of Project Management.pdfTopic 1 - Introduction of Project Management.pdf
Topic 1 - Introduction of Project Management.pdf

Topic 0 - General Information.pdf
Topic 0 - General Information.pdfTopic 0 - General Information.pdf
Topic 0 - General Information.pdf

Topic 0 - General Information New.pdf
Topic 0 - General Information New.pdfTopic 0 - General Information New.pdf
Topic 0 - General Information New.pdf

Nhan thuc ve chuyen doi so.pdf
Nhan thuc ve chuyen doi so.pdfNhan thuc ve chuyen doi so.pdf
Nhan thuc ve chuyen doi so.pdf

Recently uploaded

Basic Electronics for diploma students as per technical education Kerala Syll...
Basic Electronics for diploma students as per technical education Kerala Syll...Basic Electronics for diploma students as per technical education Kerala Syll...
Basic Electronics for diploma students as per technical education Kerala Syll...ppkakm

Introduction to Artificial Intelligence ( AI)
Introduction to Artificial Intelligence ( AI)Introduction to Artificial Intelligence ( AI)
Introduction to Artificial Intelligence ( AI)ChandrakantDivate1

Standard vs Custom Battery Packs - Decoding the Power Play
Standard vs Custom Battery Packs - Decoding the Power PlayStandard vs Custom Battery Packs - Decoding the Power Play
Standard vs Custom Battery Packs - Decoding the Power PlayEpec Engineered Technologies

Memory Interfacing of 8086 with DMA 8257
Memory Interfacing of 8086 with DMA 8257Memory Interfacing of 8086 with DMA 8257
Memory Interfacing of 8086 with DMA 8257subhasishdas79

Hospital management system project report.pdf
Hospital management system project report.pdfHospital management system project report.pdf
Hospital management system project report.pdfKamal Acharya

PE 459 LECTURE 2- natural gas basic concepts and properties
PE 459 LECTURE 2- natural gas basic concepts and propertiesPE 459 LECTURE 2- natural gas basic concepts and properties
PE 459 LECTURE 2- natural gas basic concepts and propertiessarkmank1

Online electricity billing project report..pdf
Online electricity billing project report..pdfOnline electricity billing project report..pdf
Online electricity billing project report..pdfKamal Acharya

UNIT 4 PTRP final Convergence in probability.pptx
UNIT 4 PTRP final Convergence in probability.pptxUNIT 4 PTRP final Convergence in probability.pptx
UNIT 4 PTRP final Convergence in probability.pptxkalpana413121

Digital Communication Essentials: DPCM, DM, and ADM .pptx
Digital Communication Essentials: DPCM, DM, and ADM .pptxDigital Communication Essentials: DPCM, DM, and ADM .pptx
Digital Communication Essentials: DPCM, DM, and ADM .pptxpritamlangde

Introduction to Serverless with AWS Lambda
Introduction to Serverless with AWS LambdaIntroduction to Serverless with AWS Lambda
Introduction to Serverless with AWS LambdaOmar Fathy

HAND TOOLS USED AT ELECTRONICS WORK PRESENTED BY KOUSTAV SARKAR
HAND TOOLS USED AT ELECTRONICS WORK PRESENTED BY KOUSTAV SARKARHAND TOOLS USED AT ELECTRONICS WORK PRESENTED BY KOUSTAV SARKAR
HAND TOOLS USED AT ELECTRONICS WORK PRESENTED BY KOUSTAV SARKARKOUSTAV SARKAR

Query optimization and processing for advanced database systems
Query optimization and processing for advanced database systemsQuery optimization and processing for advanced database systems
Query optimization and processing for advanced database systemsmeharikiros2

Post office management system project ..pdf
Post office management system project ..pdfPost office management system project ..pdf
Post office management system project ..pdfKamal Acharya

scipt v1.pptxcxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxx...
scipt v1.pptxcxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxx...scipt v1.pptxcxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxx...
scipt v1.pptxcxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxx...HenryBriggs2

School management system project Report.pdf
School management system project Report.pdfSchool management system project Report.pdf
School management system project Report.pdfKamal Acharya

Max. shear stress theory-Maximum Shear Stress Theory ​ Maximum Distortional ...
Max. shear stress theory-Maximum Shear Stress Theory ​  Maximum Distortional ...Max. shear stress theory-Maximum Shear Stress Theory ​  Maximum Distortional ...
Max. shear stress theory-Maximum Shear Stress Theory ​ Maximum Distortional ...ronahami

Ground Improvement Technique: Earth Reinforcement
Ground Improvement Technique: Earth ReinforcementGround Improvement Technique: Earth Reinforcement
Ground Improvement Technique: Earth ReinforcementDr. Deepak Mudgal

Augmented Reality (AR) with Augin Software.pptx
Augmented Reality (AR) with Augin Software.pptxAugmented Reality (AR) with Augin Software.pptx
Augmented Reality (AR) with Augin Software.pptxMustafa Ahmed

AIRCANVAS[1].pdf mini project for btech students
AIRCANVAS[1].pdf mini project for btech studentsAIRCANVAS[1].pdf mini project for btech students
AIRCANVAS[1].pdf mini project for btech studentsvanyagupta248

Recently uploaded (20)

Integrated Test Rig For HTFE-25 - Neometrix
Integrated Test Rig For HTFE-25 - NeometrixIntegrated Test Rig For HTFE-25 - Neometrix
Integrated Test Rig For HTFE-25 - Neometrix

Basic Electronics for diploma students as per technical education Kerala Syll...
Basic Electronics for diploma students as per technical education Kerala Syll...Basic Electronics for diploma students as per technical education Kerala Syll...
Basic Electronics for diploma students as per technical education Kerala Syll...

Introduction to Artificial Intelligence ( AI)
Introduction to Artificial Intelligence ( AI)Introduction to Artificial Intelligence ( AI)
Introduction to Artificial Intelligence ( AI)

Standard vs Custom Battery Packs - Decoding the Power Play
Standard vs Custom Battery Packs - Decoding the Power PlayStandard vs Custom Battery Packs - Decoding the Power Play
Standard vs Custom Battery Packs - Decoding the Power Play

Memory Interfacing of 8086 with DMA 8257
Memory Interfacing of 8086 with DMA 8257Memory Interfacing of 8086 with DMA 8257
Memory Interfacing of 8086 with DMA 8257

Hospital management system project report.pdf
Hospital management system project report.pdfHospital management system project report.pdf
Hospital management system project report.pdf

PE 459 LECTURE 2- natural gas basic concepts and properties
PE 459 LECTURE 2- natural gas basic concepts and propertiesPE 459 LECTURE 2- natural gas basic concepts and properties
PE 459 LECTURE 2- natural gas basic concepts and properties

Online electricity billing project report..pdf
Online electricity billing project report..pdfOnline electricity billing project report..pdf
Online electricity billing project report..pdf

UNIT 4 PTRP final Convergence in probability.pptx
UNIT 4 PTRP final Convergence in probability.pptxUNIT 4 PTRP final Convergence in probability.pptx
UNIT 4 PTRP final Convergence in probability.pptx

Digital Communication Essentials: DPCM, DM, and ADM .pptx
Digital Communication Essentials: DPCM, DM, and ADM .pptxDigital Communication Essentials: DPCM, DM, and ADM .pptx
Digital Communication Essentials: DPCM, DM, and ADM .pptx

Introduction to Serverless with AWS Lambda
Introduction to Serverless with AWS LambdaIntroduction to Serverless with AWS Lambda
Introduction to Serverless with AWS Lambda

HAND TOOLS USED AT ELECTRONICS WORK PRESENTED BY KOUSTAV SARKAR
HAND TOOLS USED AT ELECTRONICS WORK PRESENTED BY KOUSTAV SARKARHAND TOOLS USED AT ELECTRONICS WORK PRESENTED BY KOUSTAV SARKAR
HAND TOOLS USED AT ELECTRONICS WORK PRESENTED BY KOUSTAV SARKAR

Query optimization and processing for advanced database systems
Query optimization and processing for advanced database systemsQuery optimization and processing for advanced database systems
Query optimization and processing for advanced database systems

Post office management system project ..pdf
Post office management system project ..pdfPost office management system project ..pdf
Post office management system project ..pdf

scipt v1.pptxcxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxx...
scipt v1.pptxcxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxx...scipt v1.pptxcxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxx...
scipt v1.pptxcxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxxx...

School management system project Report.pdf
School management system project Report.pdfSchool management system project Report.pdf
School management system project Report.pdf

Max. shear stress theory-Maximum Shear Stress Theory ​ Maximum Distortional ...
Max. shear stress theory-Maximum Shear Stress Theory ​  Maximum Distortional ...Max. shear stress theory-Maximum Shear Stress Theory ​  Maximum Distortional ...
Max. shear stress theory-Maximum Shear Stress Theory ​ Maximum Distortional ...

Ground Improvement Technique: Earth Reinforcement
Ground Improvement Technique: Earth ReinforcementGround Improvement Technique: Earth Reinforcement
Ground Improvement Technique: Earth Reinforcement

Augmented Reality (AR) with Augin Software.pptx
Augmented Reality (AR) with Augin Software.pptxAugmented Reality (AR) with Augin Software.pptx
Augmented Reality (AR) with Augin Software.pptx

AIRCANVAS[1].pdf mini project for btech students
AIRCANVAS[1].pdf mini project for btech studentsAIRCANVAS[1].pdf mini project for btech students
AIRCANVAS[1].pdf mini project for btech students

Topic 11 - Project Schedule Management.pdf

  • 3. Process Groups & Knowledge Areas Mapping Knowledge Areas Process Groups Initiating Planning Executing Monitoring & Controlling Closing Integration Develop Project Charter Develop Project Management Plan Direct and Manage Project Work Manage Project Knowledge Monitor and Control Project Work Perform Integrated Change Control Close Project or Phase Scope Plan Scope Management Collect Requirements Define Scope Create WBS Validate Scope Control Scope Schedule Plan Schedule Management Define Activities Sequence Activities Estimate Activity Durations Develop Schedule Control Schedule Cost Plan Cost Management Estimate Costs Determine Budget Control Costs Quality Plan Quality Management Manage Quality Control Quality Resource Plan Resource Management Estimate Activity Resources Acquire Resources Develop Team Manage Team Control Resources Communications Plan Communications Management Manage Communications Monitor Communications Risk Plan Risk Management Identify Risks Perform Qualitative Risk Analysis Perform Quantitative Risk Analysis Plan Risk Responses Implement Risk Responses Monitor Risks Procurement Plan Procurement Management Conduct Procurements Control Procurements Stakeholder Identify Stakeholders Plan Stakeholder Engagement Manage Stakeholder Engagement Monitor Stakeholder Engagement 3
  • 4. Project Schedule Management Knowledge Area Process Groups Initiating Planning Executing Monitoring & Controlling Closing Time • Plan Schedule Management • Define Activities • Sequence Activities • Estimate Activity Durations • Develop Schedule • Control Schedule Enter phase/ Start project Exit phase/ End project Initiating Processes Closing Processes Planning Processes Executing Processes Monitoring & Controlling Processes 4
  • 5. Project Schedule Management • The process required to manage timely completion of the project. • Project time management starts with planning by the project management team (not shown as a discrete process). • In small projects, defining & sequencing activities, estimating activity resources & durations, developing schedule model are viewed as a single process. 5
  • 6. 1 - Plan Schedule Management • Process of establishing the policies, procedures, and documentation for planning, developing, managing, executing, and controlling the project schedule. • Work package decomposed into activities (schedule activities). • In the real word, sometime we skip define activities since we take WBS down to the activity level. Inputs 1. Project management plan 2. Project charter 3. Enterprise environmental factors 4. Organizational process assets Tools & Techniques 1. Expert judgment 2. Analytical techniques 3. Meetings Outputs 1. Schedule management plan 6
  • 7. 1 - Plan Schedule Management 7
  • 8. Schedule Management Plan (Outputs) • Project schedule model development; • Level of accuracy; • Units of measure; • Organizational procedures links; • Project schedule model maintenance; • Control thresholds; • Rules of performance measurement; • Reporting formats; • Process descriptions. 8
  • 9. 2 - Define Activities • Process of identifying and documenting the specific actions to be performed to produce the project deliverables. Inputs 1. Schedule management plan 2. Scope baseline 3. Enterprise environmental factors 4. Organizational process assets Tools & Techniques 1. Decomposition 2. Rolling wave planning 3. Expert judgment Outputs 1. Activity list 2. Activity attributes 3. Milestone list 9
  • 10. 2 - Define Activities 10
  • 11. Techniques for Defining Activities • Decomposition: Dividing and subdividing the project scope and project deliverables into smaller, more manageable parts. • Rolling Wave Planning: Progressive elaboration (iterative) planning where you do not to plan activities until you start the project management process for that phase is in the project life cycle. 11
  • 12. Outputs for Defining Activities • Activity Attributes: – Use for schedule development, selecting, ordering, sorting the planned schedule activities; – Used to identify e.g. responsible person, place, level of effort (LOE), apportioned effort (AE). • Milestone list: – Milestone is a significant point or event in the project: • Not a work activity; • Checkpoint to help control the project; – Additional milestones can be added in Sequence Activities & Develop Schedule process; – The list can indicate the level of milestones (mandatory, optional, etc). 12
  • 13. 3 - Sequence Activities • Process of identifying and documenting relationship among the project activities. Inputs 1. Schedule management plan 2. Activity list 3. Activity attributes 4. Milestone list 5. Project scope statement 6. Enterprise environmental factors 7. Organizational process assets Tools & Techniques 1. Precedence diagramming method (PDM) 2. Dependency determination 3. Leads and lags Outputs 1. Project schedule network diagrams 2. Project documents updates 13
  • 14. 3 - Sequence Activities 14
  • 15. Precedence Diagramming Method (PDM) • Precedence Diagramming Method (PDM) or Activity-on-Node (AON): – Method used in Critical Path Methodology (CPM); – No dummy activities; – Logical relationship: • Finish-to-Start (FS); • Finish-to-Finish (FF); • Start-to-Start (SS); • Start-to-Finish (SF). 15
  • 16. Precedence Diagramming Method (PDM) - Applying Leads & Lags • Use leads and lags to support realistic and achievable project schedule. • Each activity is connected at least to one predecessor and one successor except the start and the end. • Leads: – May be added to start an activity before the predecessor activity is complete. • Lags: – Inserted waiting time between activities. A B C Predecessor Successor A B A B 16
  • 17. Precedence Diagramming Method (PDM) - Example • Example of PDM which showing logical relationship and leads or lags: • Other methods to draw network diagram: – ADM (Arrow Diagramming Method) or AOA (Activity-on-Arrow); – GERT (Graphical Evaluation and Review Technique): Allows loops between activities. 17
  • 18. Precedence Diagramming Method (PDM) - Dependency Determination • To define sequence among activity, these types of dependency are used: 1. Mandatory (hard logic): – Inherent in the nature of work being done or required by the contract or legal; – E.g. you must design before you can develop. 2. Discretionary (preferred, preferential, or soft logic): – Define based on knowledge of best practices; – Can be changed if needed; – Important when how to shorten or re-sequence the project. 3. External: Involve a relationship between project activities and non-project activities 4. Internal: Involve a precedence relationship between project activities and are generally inside the project. Network diagram: • ≠ PERT (Program Evaluation and Review Technique) chart; • Shows just dependencies (logical relationship); • Could show the critical path if activity duration estimates added. 18
  • 19. Precedence Diagramming Method (PDM) - Description of a Node • Description of a node (activity, task): – ES = Earliest Start; – LS = Latest Start; – EF = Earliest Finish; – LF = Latest Finish; – EF = ES + D - 1; – LS = LF - D + 1; – Float (F) = LS - ES = LF – EF. 19
  • 20. Estimate Activity Resource (Inputs, Tools & Techniques) • Resource calendar: – Information (skill, location, etc) in which resource (people, equipment, material, etc) are potentially available. • Published estimating data: – Use company’s rates. • Bottom up estimating: – Activity is decomposed to be more confidence in estimating. • Alternative analysis: – Levels of resource capability or skills; – Different size or type of machines; – Different tools (hand versus automated); – Make-rent-or-buy decisions regarding the resource. 20
  • 21. 4 - Estimate Activity Durations • Process of estimating the number of work periods needed to complete individual activities with estimated resources. • Schedule shall be as believable and realistic as possible (do not allow padding). Inputs 1. Schedule management plan 2. Activity list 3. Activity attributes 4. Activity resource requirements 5. Resource calendars 6. Project scope statement 7. Risk register 8. Resource breakdown structure 9. Enterprise environmental factors 10.Organizational process assets Tools & Techniques 1. Expert judgment 2. Analogous estimating 3. Parametric estimating 4. Three-point estimates 5. Group decision making techniques 6. Reserve analysis Outputs 1. Activity duration estimates 2. Project documents updates 21
  • 22. 4 - Estimate Activity Durations 22
  • 23. Estimate Activity Durations (Tools & Techniques) • Analogous estimating (Top down): – Use actual duration of previous activity (historical) that has similarity. • Parametric estimating: – Use statistical relationship between historical data and other variables (e.g. learning curve); – The result can become heuristics (experience based technique / rule of thumb). • Reserve analysis (buffer): – Includes contingency reserves. • A Buffer isn’t a Padding. A Padding is extra time added to a schedule that you don’t really think you need but that you add just to feel confident in the estimate. Padding is when we take a conventional approach to building a Gantt chart, come up with three months, but tell our boss four months. 23
  • 24. • Also called Program Evaluation and Review Technique (PERT); • Use for time and cost estimation; • Expected activity duration (EAD), Standard deviation (SD) and Variance (V) calculated from Most-likely (M), Optimistic (O), Pessimistic (P); • Range of estimate = EAD +/- SD; • Duration uncertainty = Confidence interval (CI) = P - O; • Assuming a ± 3 sigma CI, we have: • Standard deviation cannot be sum; • Variance used to calculate total SD of the project. 3-Point Estimate (PERT) Expected 6 Ο 4Μ P   Standard Deviation () 6 Ο P  Variance 2 6 Ο P          variance SD 24
  • 25. Exercise: 3-Point Estimate (PERT) • Question: – Together with your team, you applied 3-point estimation on a critical path which consists of two activities. The following duration uncertainties are all calculated in assuming a ± 3 sigma confidence interval. – The duration uncertainty - defined as pessimistic minus optimistic - of the first activity is 18 days; the second estimate has an uncertainty of 24 days. Applying the PERT formula for paths, what is the duration uncertainty of the entire path? A. 21 days; B. 30 days; C. 42 days; D. No statement is possible from the information given. 25
  • 26. Exercise: 3-Point Estimate (PERT) • Answer: – See that the question says that duration uncertainty is pessimistic minus optimistic, in other words P - O. We know that SD is (P - O) / 6, thus SD is “duration certainty” / 6; – Thus: • For path 1 : SD = 18 / 6 = 3; Variance = 3 * 3 = 9; • For path 2 : SD = 24 / 6 = 4; Variance = 4 * 4 = 16; – Total path variance = 16 + 9 = 25; – Total path SD = (P - O) / 6 = Sqrt (25) = 5; – DURATION UNCERTAINTY = P - O = 5 * 6 = 30. 26
  • 27. 5 - Develop Schedule • Process of analyzing activity sequences, durations, resource requirements, and schedule constraints to create the project schedule model. Inputs 1. Schedule management plan 2. Activity list 3. Activity attributes 4. Project schedule network diagrams 5. Activity resource requirements 6. Resource calendars 7. Activity duration estimates 8. Project scope statement 9. Risk register 10.Project staff assignments 11.Resourse breakdown structure 12.Enterprise environmental factors 13.Organizational process assets Tools & Techniques 1. Schedule network analysis 2. Critical path method 3. Critical chain method 4. Resource optimization techniques 5. Modeling techniques 6. Leads and lags 7. Schedule compression 8. Scheduling tool Outputs 1. Schedule baseline 2. Project schedule 3. Schedule data 4. Project calendars 5. Project management plan updates 6. Project documents updates 27
  • 28. 5 - Develop Schedule 28
  • 29. Critical Path (Tools & Techniques) • Critical Path is the longest duration path; • Identify the shortest time needed to complete a project; • There can be more than one critical path; • We don’t want critical path, it increases risk; • Don’t leave a project with a negative float, you would compress the schedule; • Near-critical path is the path that has close in duration to critical path. • Float (Slack): – Total float: The amount of time an activity can be delayed without delaying the project end date or intermediary milestone; – Free float: The amount of time an activity can be delayed without delaying the early start date of its successor(s); – Project float: The amount of time an activity can be delayed without delaying the externally imposed project completion date required by customer / management. 29
  • 30. Critical Path Method Basic (Tools & Techniques) Activity Precedence Duration A 2 B 3 C A 1 D B 4 E B 2 F C 1 G D, F 5 H E 2 I H 2 J G, I 0 K • Dummy activity = 0 resource & 0 duration; • Critical activities: – All activities in the critical path; – Delay in the completion of these activities will lengthen the project timescale; – Has float = 0. 30
  • 31. Forward Pass Backward Pass ID Critical Path using PDM (Tools & Techniques) • Calculation: – Forward Pass to calculte ES, EF: • ES + D = ES (successor); • Use highest value on join. – Backward Pass to calculate LS, LF: • LS - D (predecessor) = LS (predecessor); • Use lowest value on join. 31
  • 32. Exercise Questions: • What is the critical path? • What is critical path duration? • What is float (slack) duration of activity A30? Answers: • - • - • - A60 A50 32
  • 33. • The longest duration path through the project considering both activity dependencies and resource constraints. • Network diagram and critical path are identified first. • Type of buffers: – Project buffer; – Feeding buffer; – Resource buffer. Critical Chain (Buffer Management) (Tools & Techniques) 33
  • 34. • Resource leveling: – Start and finish dates are adjusted based on resource constraints with the goal of balancing demand for resources with the available supply; – Can be used when shared or critically required resources are only available at certain times, or in limited quantities, or over-allocated. • Resource smoothing: – Adjusts the activities of a schedule model such that the requirements for resources on the project do not exceed certain predefined resource limits; – The critical path is not changed and the completion date may not be delayed. Resource Optimization Techniques (Tools & Techniques) 34
  • 35. • Analysis on effect of changes on a particular thing (assumption) on the project which make activity duration change. • What-if scenario analysis: – Evaluate scenarios in order to predict their effect, positively or negatively, on project objectives; – “What if the situation ‘Y’ is represented by the scenario ‘X’ happens?” • Monte Carlo simulation: – Used when there is possibility that the critical path will be different for a given set of project conditions; – Using probability distribution for each activity or group of activities; – Using computer software; – Using three-point estimates and network diagram; – Help deal with “path convergence”: • Multiple paths converge into one or more activities (but adding risk). Modeling Techniques (Tools & Techniques) 35
  • 36. • Fast Tracking: – Performing critical path activities in parallel; – Usually increase risk and requires more attention to communication; – May need a rework; – E.g. design is half finished and start coding. • Crashing: – Analyze cost and schedule trade-offs; – Determine most compression for least cost; – Crash the tasks that cost the least first, focusing on minimizing project cost; – Always results in increased cost. Schedule Compression (Tools & Techniques) 36
  • 37. Project Schedule (Outputs) • Schedule can be shown with or without dependencies (logical relationship). • Presented as: – Summary form e.g. Master schedule, Milestone schedule; – Detailed form. • Format: – Network diagram; – Milestone chart; – Bar chart (Gantt chart). 37
  • 38. Schedule Data (Outputs) • Includes at least: – Schedule milestone; – Schedule activities; – Activity attributes; – Assumptions & Constraints. • Additional information can be added, such as: – Resource histograms; – Cash-flow projections; – Order & delivery schedules; – Alternative schedules. 38
  • 39. 6 - Control Schedule • Process of monitoring the status of project activities to update project progress and manage changes to the schedule baseline to achieve the plan. Inputs 1. Project management plan 2. Project schedule 3. Work performance data 4. Project calendars 5. Schedule data 6. Organizational process assets Tools & Techniques 1. Performance reviews 2. Project management Software 3. Resource optimization techniques 4. Modeling techniques 5. Leads & lags 6. Schedule compression 7. Scheduling tool Outputs 1. Work performance information 2. Schedule forecasts 3. Change requests 4. Project management plan updates 5. Project documents updates 6. Organizational process assets updates 39
  • 40. 6 - Control Schedule 40
  • 41. Thank You Next topic: Project Cost Management 41
