JAIPUR METRO RAIL PROJECT
The Metro Way Of Life
2012-2013
(01 June 2012 – 30 June 2012)
Presented By:
Anchal Meena , Asha Chaudhary
Arpit Hada, Poonam Shekhawat
PriyankaMeena, Narendra Singh
Shruti Shilpi
Submitted To:
Dr. B.P.Suneja
(Head of PTP)
Introduction
 Jaipur Metro Rail project, a company under the name Jaipur Metro Rail
Corporation Limited was incorporated on 01.01.2010 under Companies
Act,1956.
 DSC Limited is an infrastructure group started as an Indian Construction
Company 70 years ago.
 It has full capabilities from developing, financing constructing and operating
infrastructure projects across various infrastructure sectors in India and
abroad.
Vision
To be the leading infrastructure developer of choice.
Mission
Efficient, rapid and innovative development of quality infrastructure to
create infrawealth for the nation.
Introduction
Jaipur Metro Rail project, aIcomnpatnyrunodedr thue ncamte Jiaoipunr Metro Rail Corporation
Limited was incorporated on 01.01.2010 under Companies Act,1956.

STAGES
• Mansarover to Chandpole: 9.25 km
Chandpole to badichopad : 2.3 km
(approx.)
• Executed by : D.M.R.C
• Est. cost : Rs 1250 Crores
• Est. D.O.C : Febrary 2013
• Operational Comission of the stage :
June 2013
• Ambabari to Sitapura : 23.5 km
• Executed by : P.P.P
• Est. cost : Rs 8750 Crores
• East. D.O.C : Febrary 2015
• Operational Comission of the stage :
June 2015

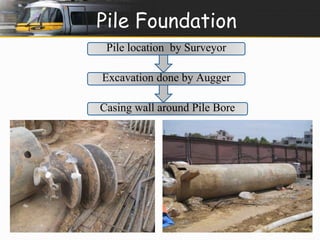

Pile Foundation
Pile location by Surveyor
Excavation done by Augger
Casing wall around Pile Bore
Layout plan of pile group

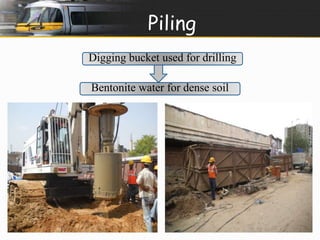

Piling
Digging bucket used for drilling
Bentonite water for dense soil

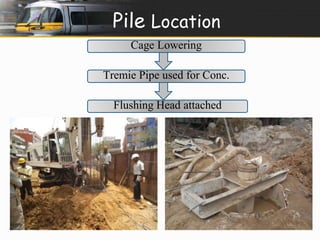

Pile Location
Cage Lowering
Tremie Pipe used for Conc.
Flushing Head attached

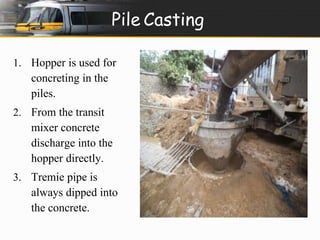

Pile Casting
1. Hopper is used for
concreting in the
piles.
2. From the transit
mixer concrete
discharge into the
hopper directly.
3. Tremie pipe is
always dipped into
the concrete.

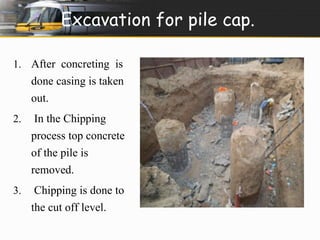

Excavation for pile cap.
1. After concreting is
done casing is taken
out.
2. In the Chipping
process top concrete
of the pile is
removed.
3. Chipping is done to
the cut off level.

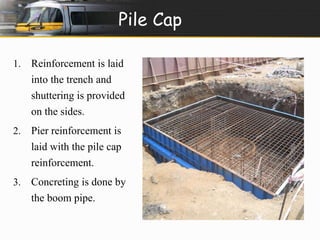

Pile Cap
1. Reinforcement is laid
into the trench and
shuttering is provided
on the sides.
2. Pier reinforcement is
laid with the pile cap
reinforcement.
3. Concreting is done by
the boom pipe.

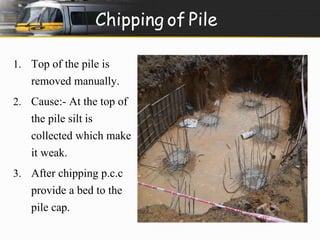

Chipping of Pile
1. Top of the pile is
removed manually.
2. Cause:- At the top of
the pile silt is
collected which make
it weak.
3. After chipping p.c.c
provide a bed to the
pile cap.
Pier
1. The size of pier is 1.8 m
to 2.0 m dia. of cir. shape.
2. A required clearance of
5.5 m on road side.
3. The min. ht. of rail above
the existing road is 8.4 m.
4. An outward slope of
1:200 will be provided at
the pier top for the
drainage due to spilling of
rain water.
Crash barrier
1. A wall is cast around the
pier at the road level,
which is known as Crash
barrier.
2. The gap of 25 mm is
maintained between pier
and crash barrier
3. It works as a shock
absorber. And to protect
the pier from the damage
by the road accident.

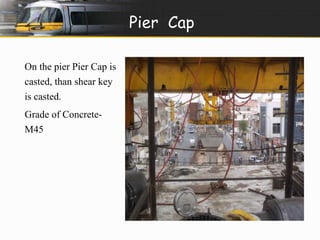

Pier Cap
On the pier Pier Cap is
casted, than shear key
is casted.
Grade of Concrete-
M45

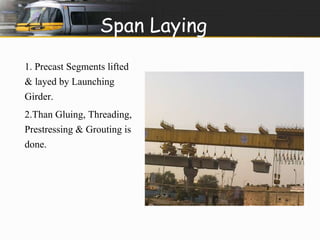

Span Laying
1. Precast Segments lifted
& layed by Launching
Girder.
2.Than Gluing, Threading,
Prestressing & Grouting is
done.

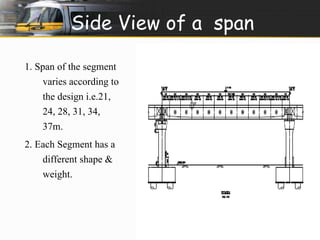

Side View of a span
1. Span of the segment
varies according to
the design i.e.21,
24, 28, 31, 34,
37m.
2. Each Segment has a
different shape &
weight.

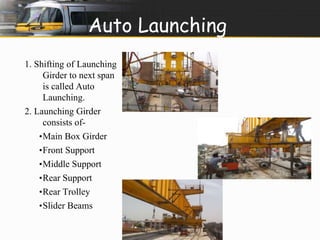

Auto Launching
1. Shifting of Launching
Girder to next span
is called Auto
Launching.
2. Launching Girder
consists of-
∙Main Box Girder
∙Front Support
∙Middle Support
∙Rear Support
∙Rear Trolley
∙Slider Beams

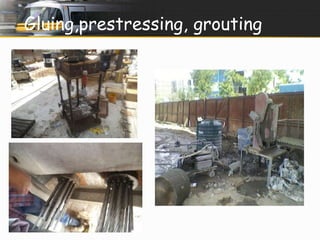

Gluing,prestressing, grouting

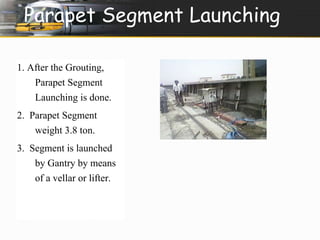

Parapet Segment Launching
1. After the Grouting,
Parapet Segment
Launching is done.
2. Parapet Segment
weight 3.8 ton.
3. Segment is launched
by Gantry by means
of a vellar or lifter.

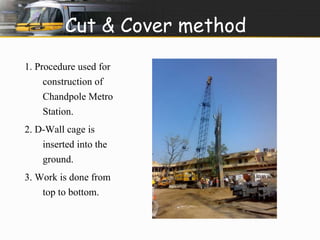

Cut & Cover method
1. Procedure used for
construction of
Chandpole Metro
Station.
2. D-Wall cage is
inserted into the
ground.
3. Work is done from
top to bottom.

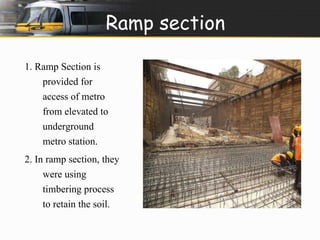

Ramp section
1. Ramp Section is
provided for
access of metro
from elevated to
underground
metro station.
2. In ramp section, they
were using
timbering process
to retain the soil.
23
24

Jaipur metro rail project

  • 1.
    JAIPUR METRO RAILPROJECT The Metro Way Of Life 2012-2013 (01 June 2012 – 30 June 2012) Presented By: Anchal Meena , Asha Chaudhary Arpit Hada, Poonam Shekhawat PriyankaMeena, Narendra Singh Shruti Shilpi Submitted To: Dr. B.P.Suneja (Head of PTP)
  • 2.
    Introduction  JaipurMetro Rail project, a company under the name Jaipur Metro Rail Corporation Limited was incorporated on 01.01.2010 under Companies Act,1956.  DSC Limited is an infrastructure group started as an Indian Construction Company 70 years ago.  It has full capabilities from developing, financing constructing and operating infrastructure projects across various infrastructure sectors in India and abroad. Vision To be the leading infrastructure developer of choice. Mission Efficient, rapid and innovative development of quality infrastructure to create infrawealth for the nation.
  • 3.
    Introduction Jaipur MetroRail project, aIcomnpatnyrunodedr thue ncamte Jiaoipunr Metro Rail Corporation Limited was incorporated on 01.01.2010 under Companies Act,1956.
  • 4.
    STAGES • Mansaroverto Chandpole: 9.25 km Chandpole to badichopad : 2.3 km (approx.) • Executed by : D.M.R.C • Est. cost : Rs 1250 Crores • Est. D.O.C : Febrary 2013 • Operational Comission of the stage : June 2013 • Ambabari to Sitapura : 23.5 km • Executed by : P.P.P • Est. cost : Rs 8750 Crores • East. D.O.C : Febrary 2015 • Operational Comission of the stage : June 2015
  • 5.
    Pile Foundation Pilelocation by Surveyor Excavation done by Augger Casing wall around Pile Bore
  • 6.
    Layout plan ofpile group
  • 7.
    Piling Digging bucketused for drilling Bentonite water for dense soil
  • 8.
    Pile Location CageLowering Tremie Pipe used for Conc. Flushing Head attached
  • 9.
    Pile Casting 1.Hopper is used for concreting in the piles. 2. From the transit mixer concrete discharge into the hopper directly. 3. Tremie pipe is always dipped into the concrete.
  • 10.
    Excavation for pilecap. 1. After concreting is done casing is taken out. 2. In the Chipping process top concrete of the pile is removed. 3. Chipping is done to the cut off level.
  • 11.
    Pile Cap 1.Reinforcement is laid into the trench and shuttering is provided on the sides. 2. Pier reinforcement is laid with the pile cap reinforcement. 3. Concreting is done by the boom pipe.
  • 12.
    Chipping of Pile 1. Top of the pile is removed manually. 2. Cause:- At the top of the pile silt is collected which make it weak. 3. After chipping p.c.c provide a bed to the pile cap.
  • 13.
    Pier 1. Thesize of pier is 1.8 m to 2.0 m dia. of cir. shape. 2. A required clearance of 5.5 m on road side. 3. The min. ht. of rail above the existing road is 8.4 m. 4. An outward slope of 1:200 will be provided at the pier top for the drainage due to spilling of rain water.
  • 14.
    Crash barrier 1.A wall is cast around the pier at the road level, which is known as Crash barrier. 2. The gap of 25 mm is maintained between pier and crash barrier 3. It works as a shock absorber. And to protect the pier from the damage by the road accident.
  • 15.
    Pier Cap Onthe pier Pier Cap is casted, than shear key is casted. Grade of Concrete- M45
  • 16.
    Span Laying 1.Precast Segments lifted & layed by Launching Girder. 2.Than Gluing, Threading, Prestressing & Grouting is done.
  • 17.
    Side View ofa span 1. Span of the segment varies according to the design i.e.21, 24, 28, 31, 34, 37m. 2. Each Segment has a different shape & weight.
  • 18.
    Auto Launching 1.Shifting of Launching Girder to next span is called Auto Launching. 2. Launching Girder consists of- ∙Main Box Girder ∙Front Support ∙Middle Support ∙Rear Support ∙Rear Trolley ∙Slider Beams
  • 19.
  • 20.
    Parapet Segment Launching 1. After the Grouting, Parapet Segment Launching is done. 2. Parapet Segment weight 3.8 ton. 3. Segment is launched by Gantry by means of a vellar or lifter.
  • 21.
    Cut & Covermethod 1. Procedure used for construction of Chandpole Metro Station. 2. D-Wall cage is inserted into the ground. 3. Work is done from top to bottom.
  • 22.
    Ramp section 1.Ramp Section is provided for access of metro from elevated to underground metro station. 2. In ramp section, they were using timbering process to retain the soil.
  • 23.
