LUCKNOW METRO RAIL CORPORATION, LUCKNOW
ABOUT METRO
• Lucknow being the metro city in Uttar Pradesh and the largest city of north and central India after Delhi and has
urban population about more than 5 million in 2015. The government decided to build a metro rail system in the
state capital.
• The Lucknow Metro is an under construction rapid transit system in the city of Lucknow, India. Construction on
the first phase began on 27 September 2014.
• Lucknow Metro Rail Corporation Limited or LMRC is responsible to build and operate this network.
• The metro project will be the most expensive public transport system in the state of Uttar Pradesh, costing
₹12500 crore (US$2 billion) in phase 1 of construction which is expected to be operational in 2018. Phase 2 will
be started in 2018.
• It will provide speedy mass transport and help in reduce traffic congestion on city roads.
• The proposed metro rail network was planned to consist of two corridors: North- South and East-West one from
Amausi to Munshi Pulia and other from Vasant Kunj to Charbagh Railway Station. Both lines will intersect at
Charbagh.
• The difference between arrival time of trains at each station is expected to be 7 minutes. This would be reduced
to 5 minutes and then to 3 minutes in phases.The work would be finished by 2018 of first phase

• Under construction Project:- 8.4 km (Amausi to Charbagh)
• Stations b/w transport nagar to charbagh:- 8 station
1. Transport nagar
2. Krishna nagar
3. Singarnagar
4. Alambagh
5. Alambagh bus station
6. Mawaiya
7. Durgapuri
8. charbagh

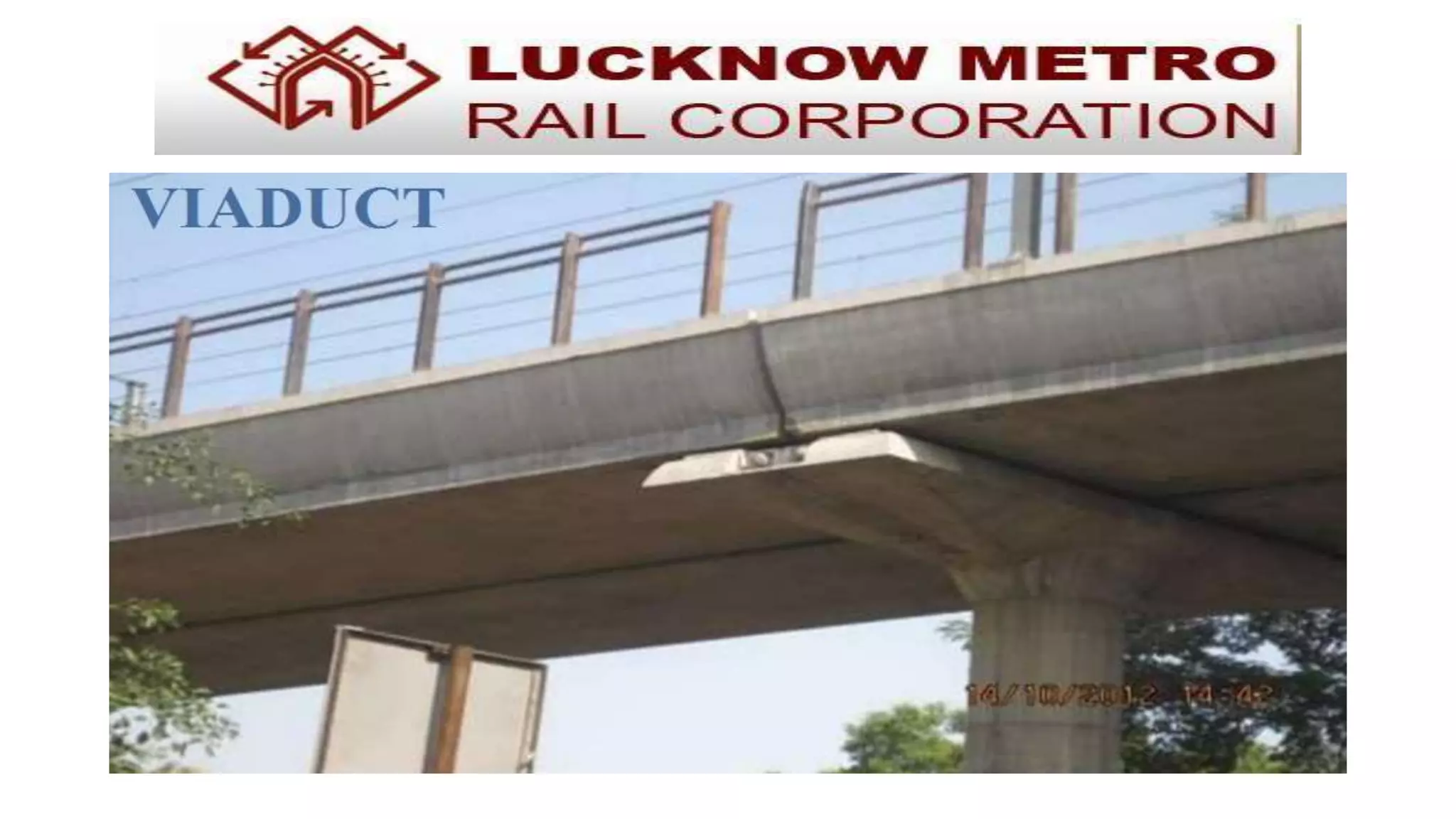

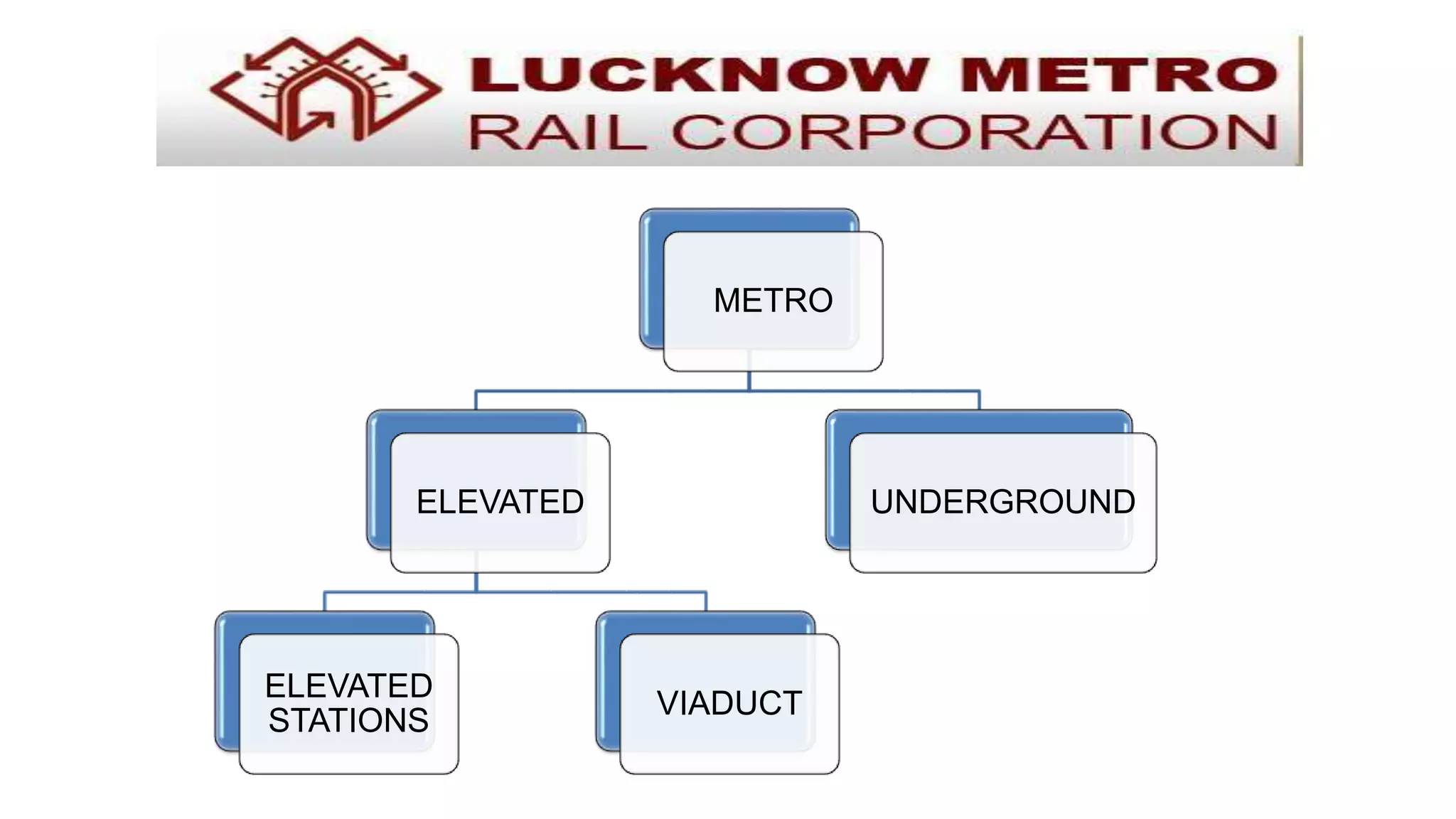

METRO
ELEVATED
ELEVATED
STATIONS
VIADUCT
UNDERGROUND

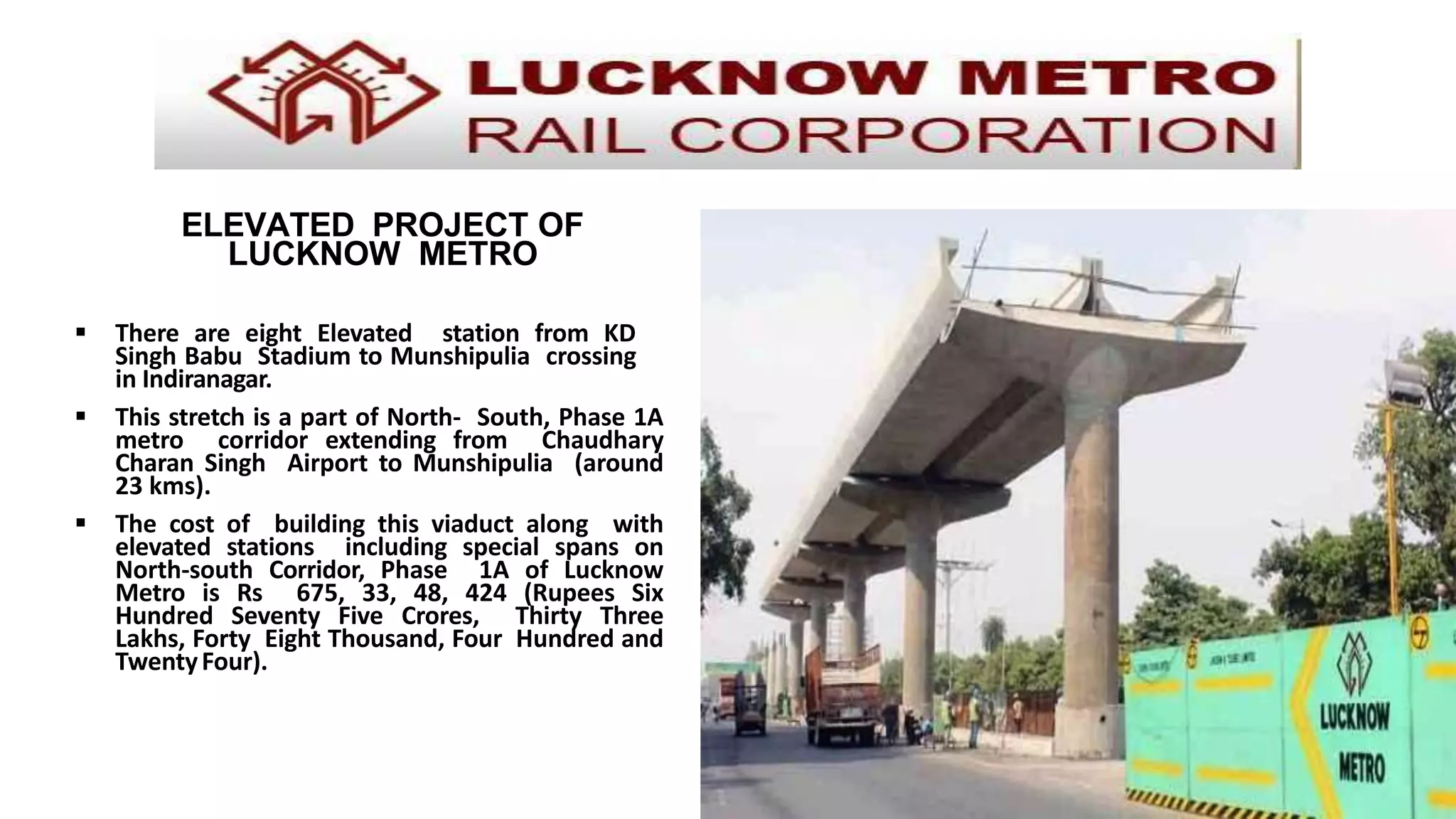

ELEVATED PROJECT OF
LUCKNOW METRO

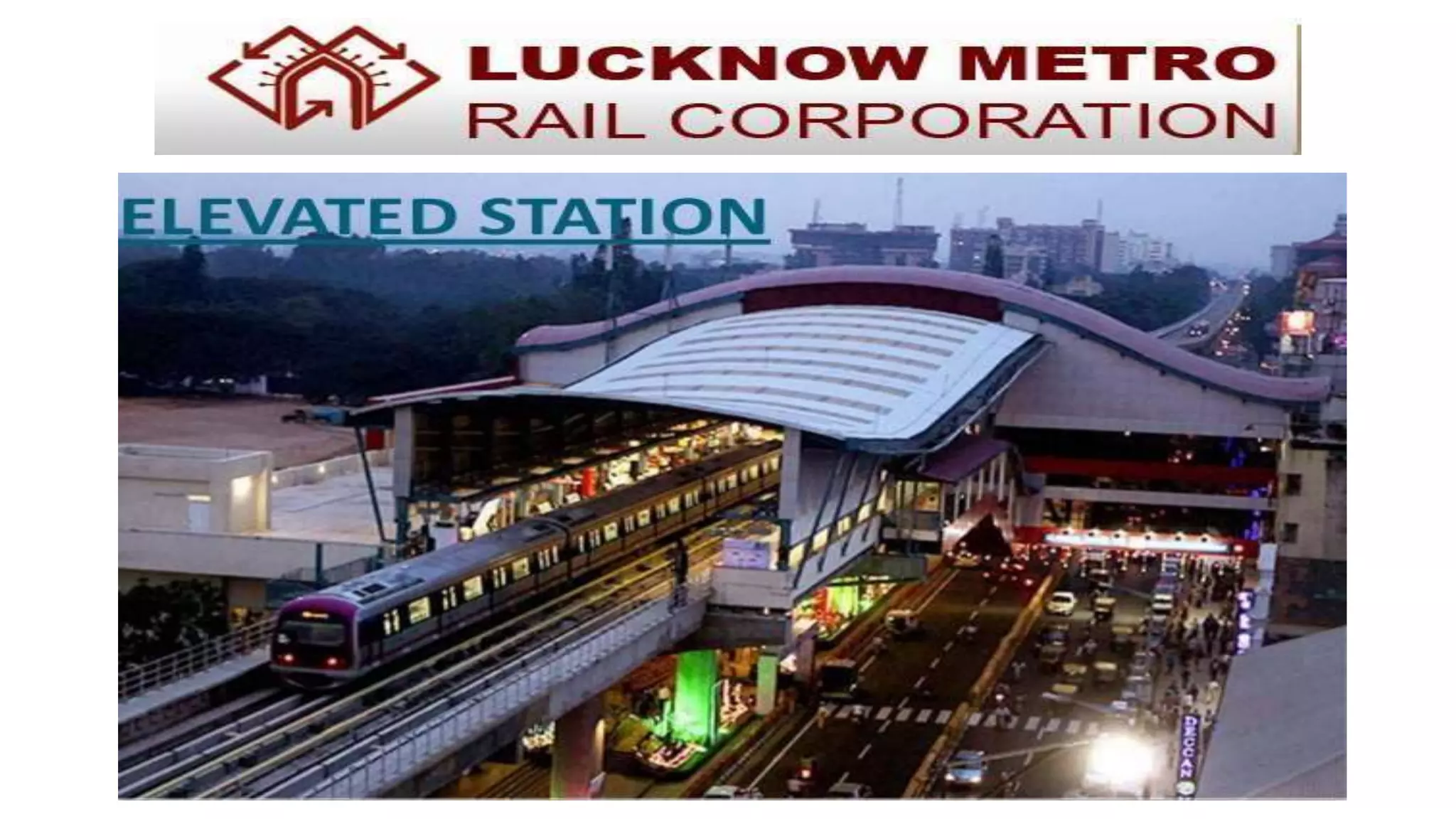

 There are eight Elevated station from KD
Singh Babu Stadium to Munshipulia crossing
in Indiranagar.
 This stretch is a part of North- South, Phase 1A
metro corridor extending from Chaudhary
Charan Singh Airport to Munshipulia (around
23 kms).
 The cost of building this viaduct along with
elevated stations including special spans on
North-south Corridor, Phase 1A of Lucknow
Metro is Rs 675, 33, 48, 424 (Rupees Six
Hundred Seventy Five Crores, Thirty Three
Lakhs, Forty Eight Thousand, Four Hundred and
TwentyFour).
WHAT IS
CASTING
YARD ??

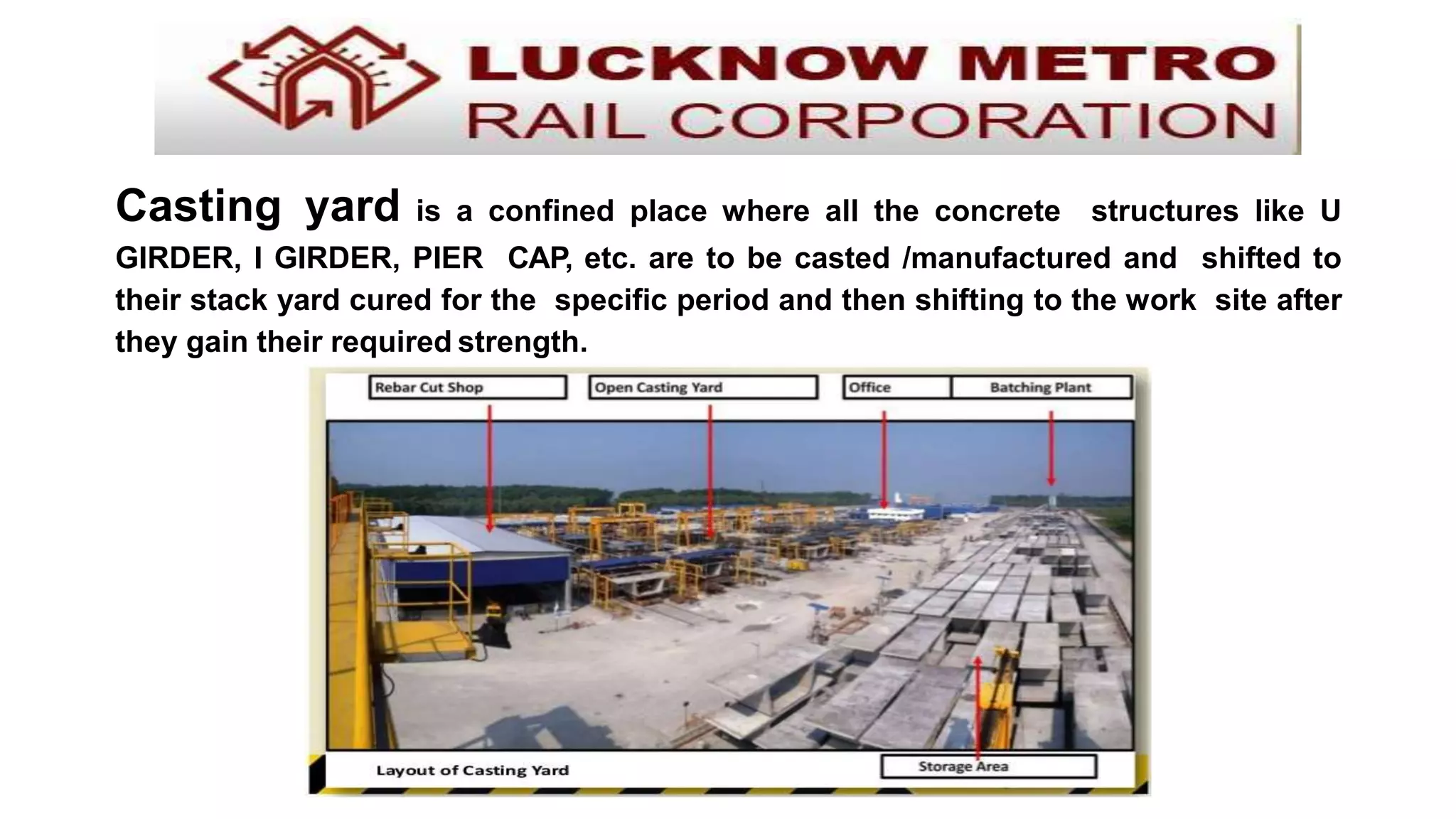

Casting yard is a confined place where all the concrete structures like U
GIRDER, I GIRDER, PIER CAP, etc. are to be casted /manufactured and shifted to
their stack yard cured for the specific period and then shifting to the work site after
they gain their required strength.

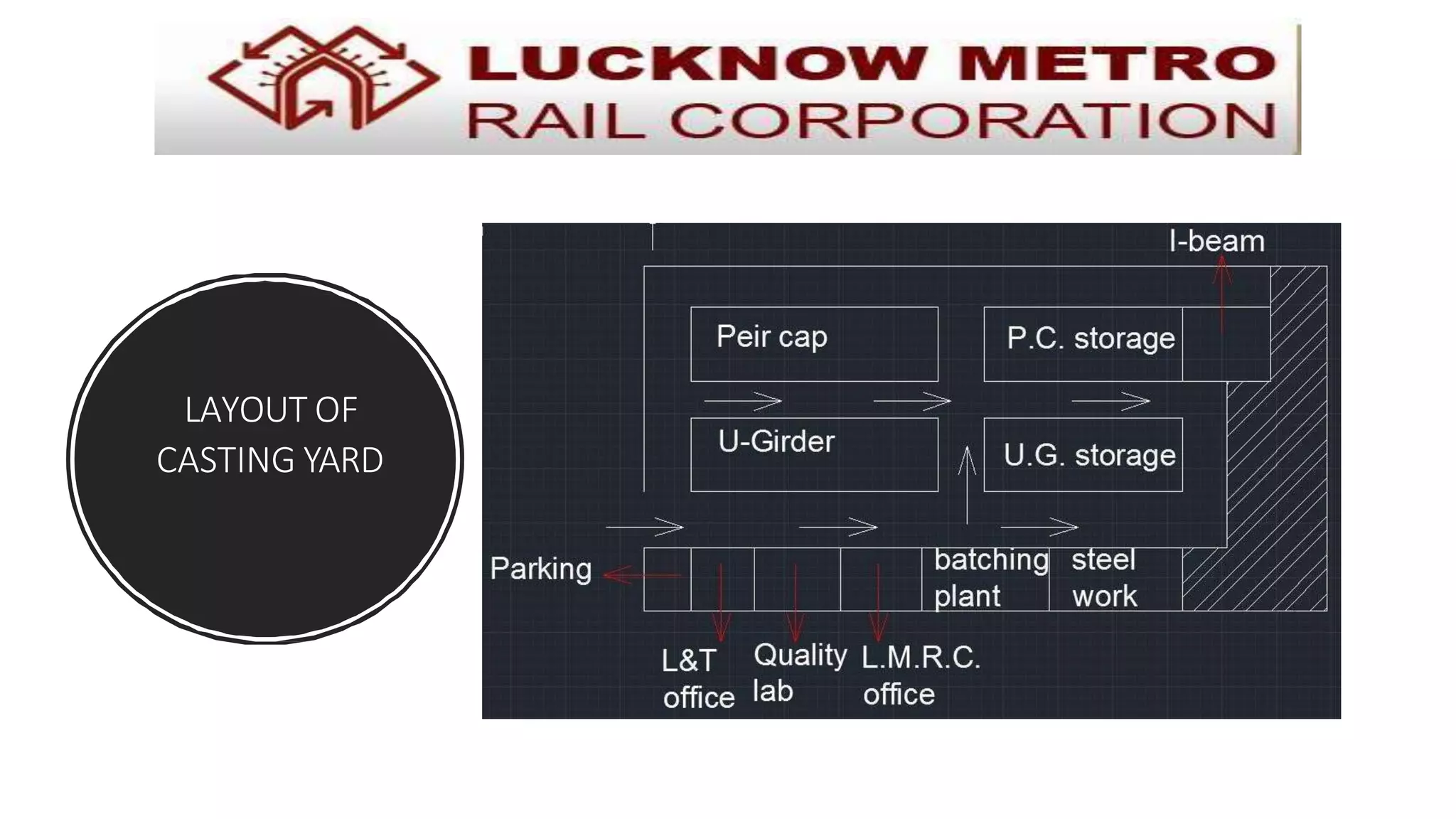

LAYOUT OF
CASTING YARD

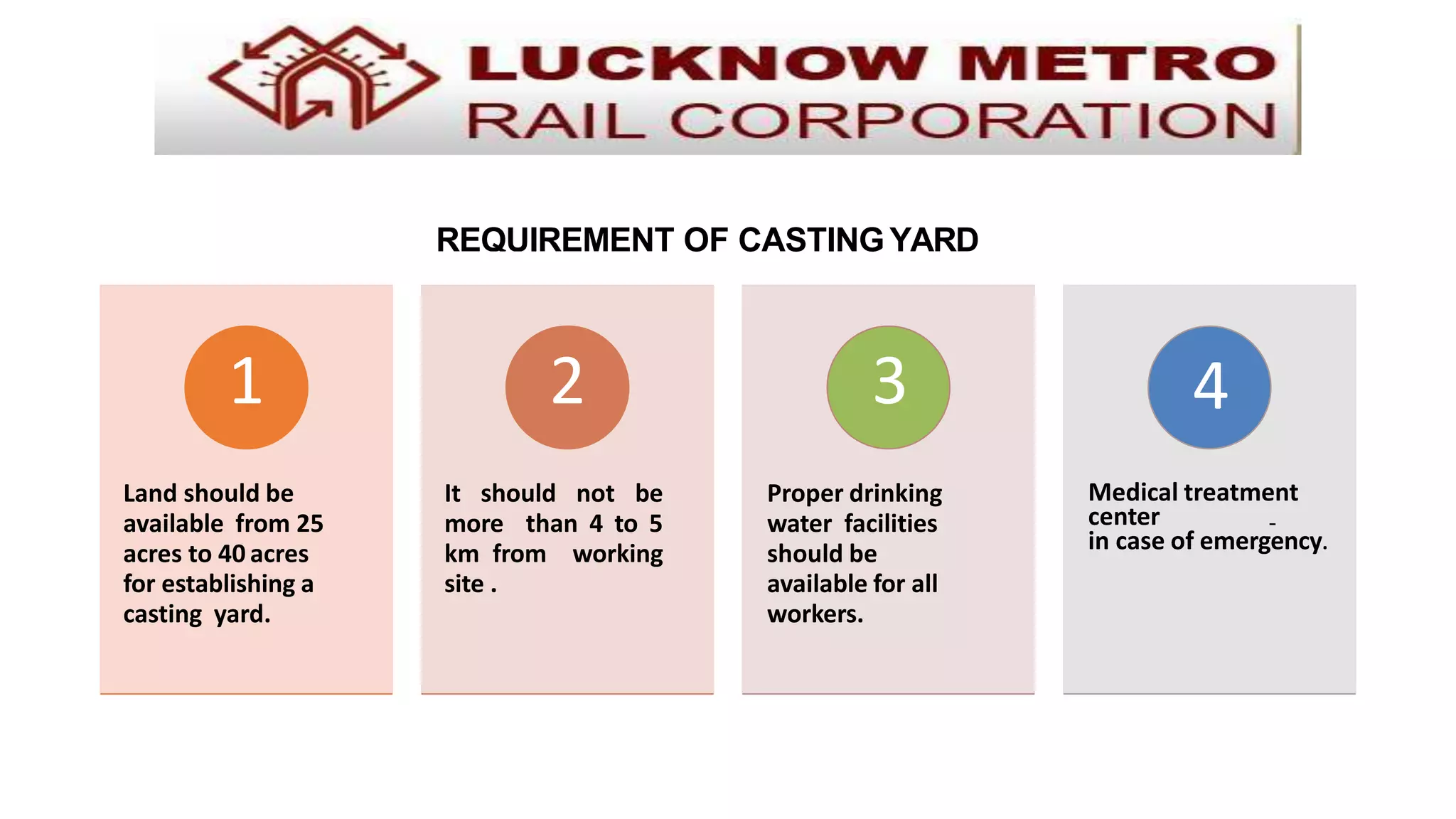

REQUIREMENT OF CASTINGYARD
1
Land should be
available from 25
acres to 40 acres
for establishing a
casting yard.
2
It should not be
more than 4 to 5
km from working
site .
3
Proper drinking
water facilities
should be
available for all
workers.
4
Medical treatment
center
in case of emergency.
U-GIRDER I-GIRDER PIER CAP
BATCHING
PLANT

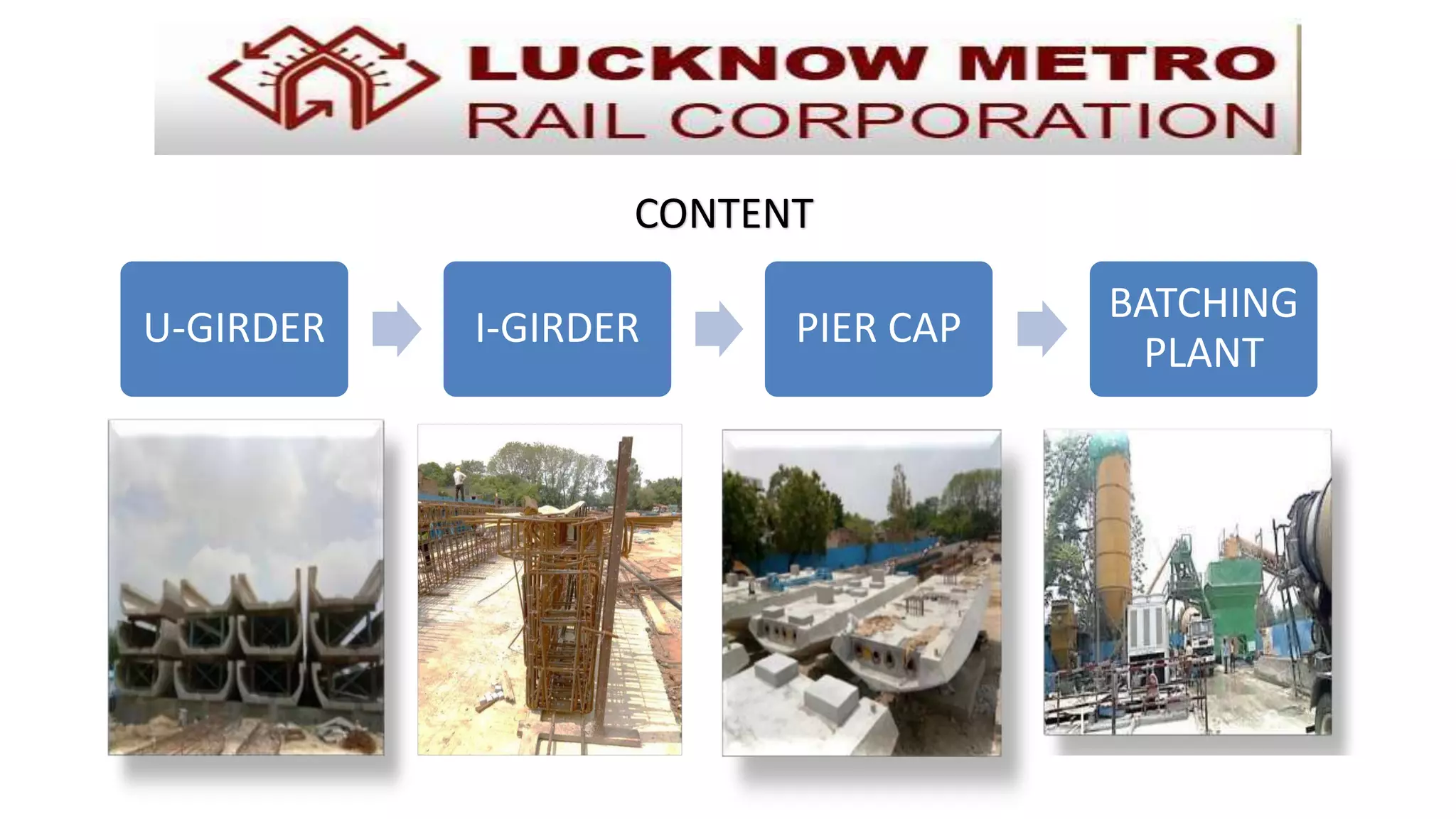

CONTENT

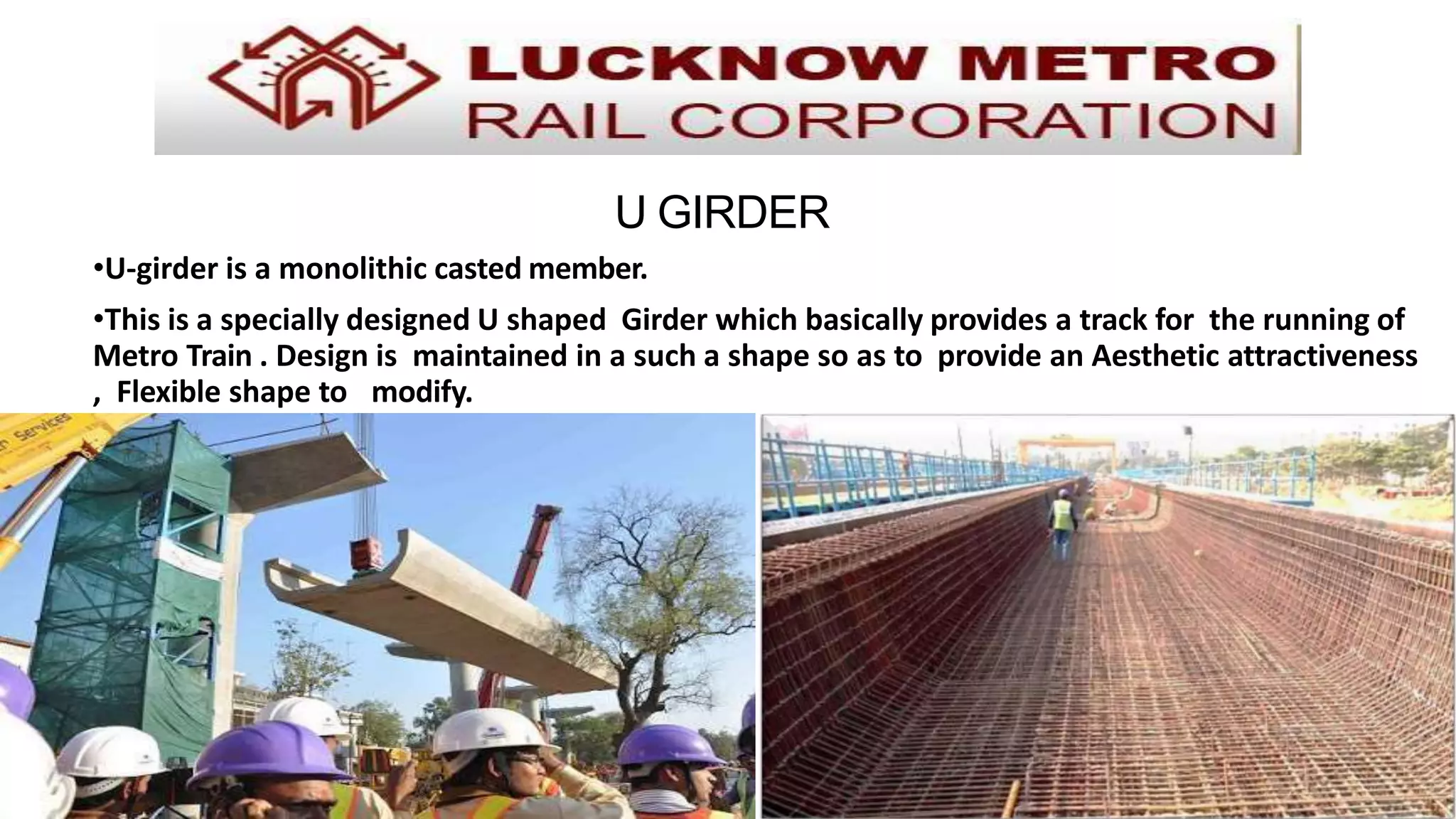

U GIRDER
•U-girder is a monolithic casted member.
•This is a specially designed U shaped Girder which basically provides a track for the running of
Metro Train . Design is maintained in a such a shape so as to provide an Aesthetic attractiveness
, Flexible shape to modify.

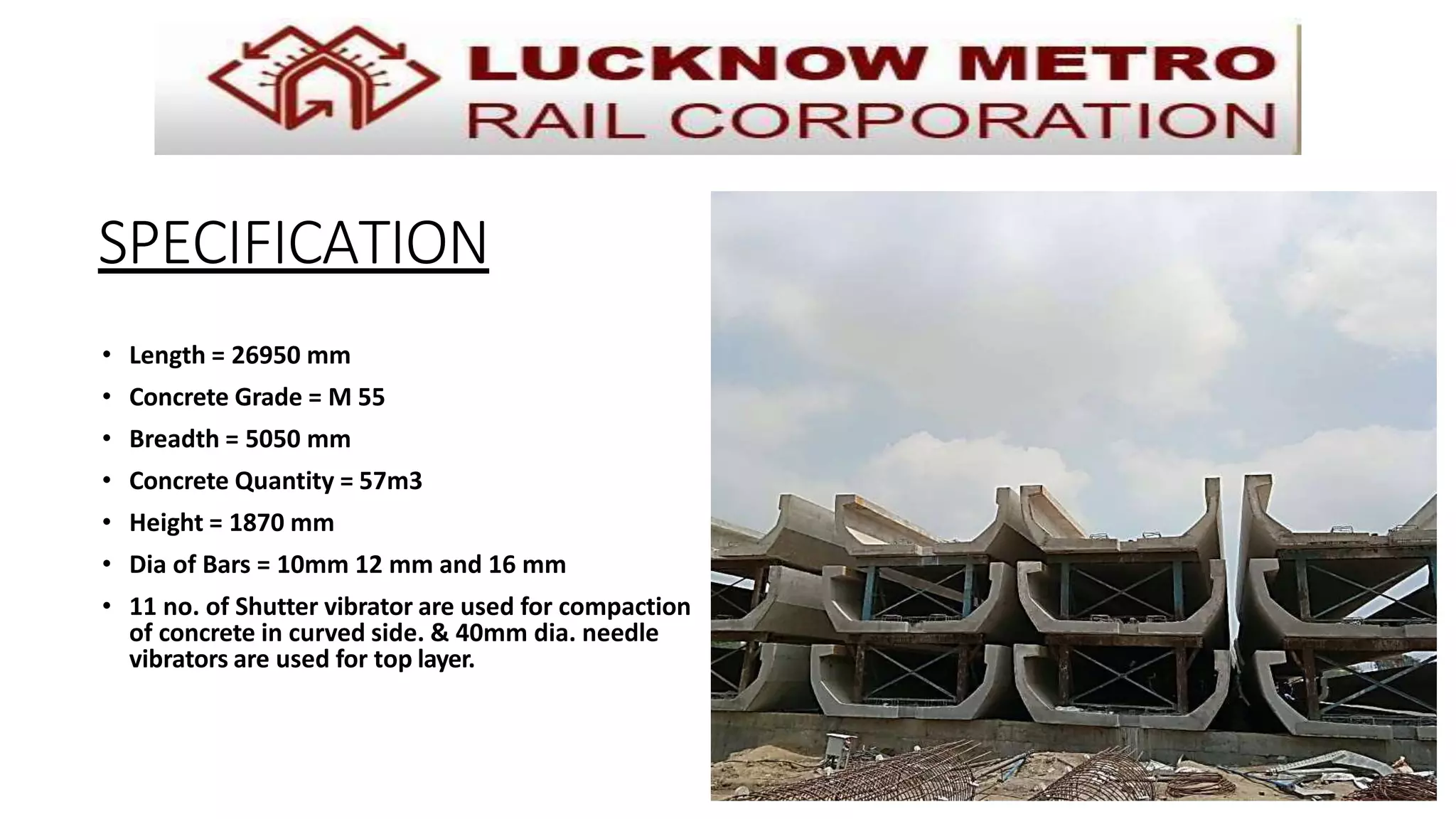

SPECIFICATION
• Length = 26950 mm
• Concrete Grade = M 55
• Breadth = 5050 mm
• Concrete Quantity = 57m3
• Height = 1870 mm
• Dia of Bars = 10mm 12 mm and 16 mm
• 11 no. of Shutter vibrator are used for compaction
of concrete in curved side. & 40mm dia. needle
vibrators are used for top layer.

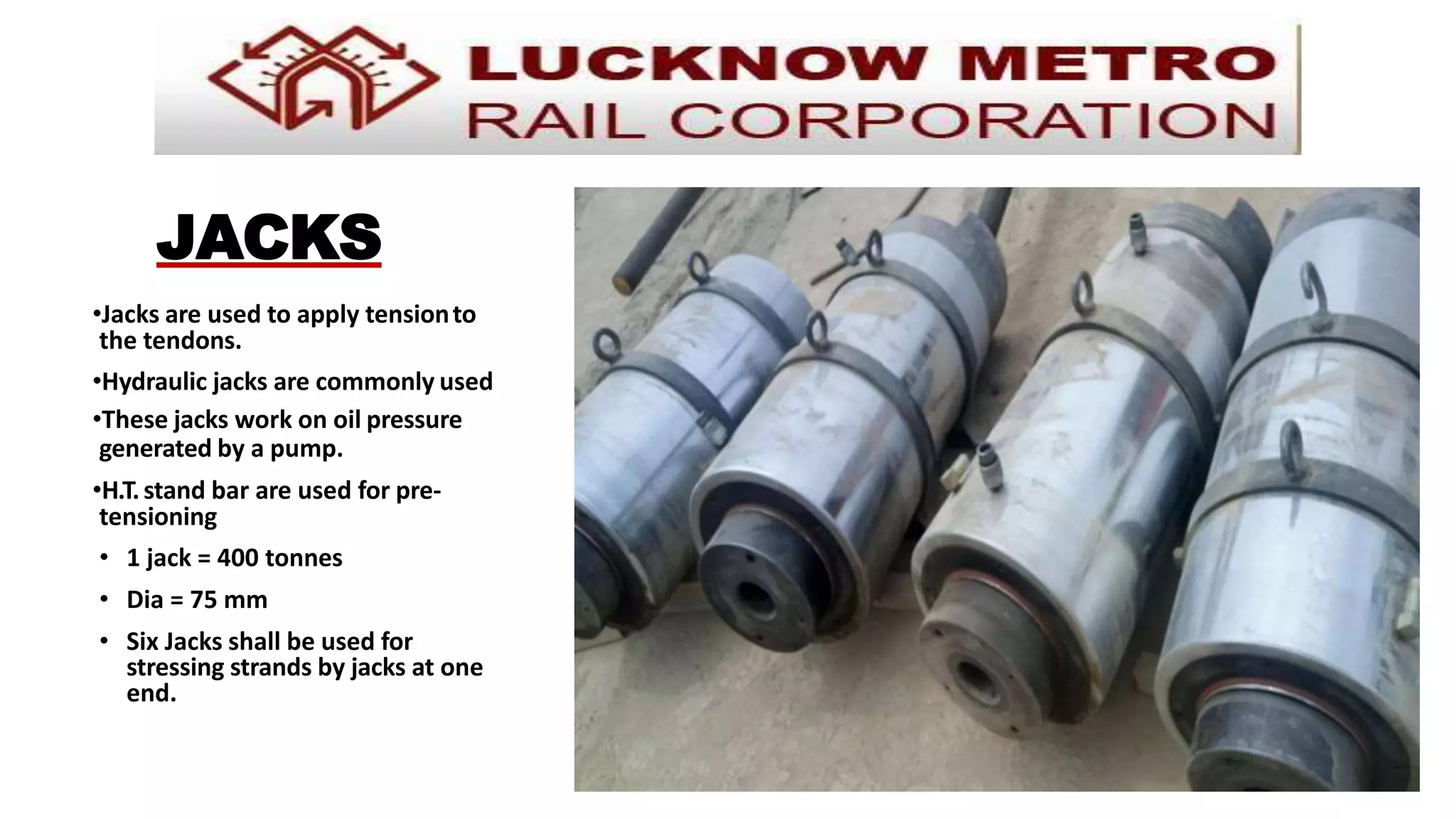

JACKS
•Jacks are used to apply tensionto
the tendons.
•Hydraulic jacks are commonly used
•These jacks work on oil pressure
generated by a pump.
•H.T.stand bar are used for pre-
tensioning
• 1 jack = 400 tonnes
• Dia = 75 mm
• Six Jacks shall be used for
stressing strands by jacks at one
end.

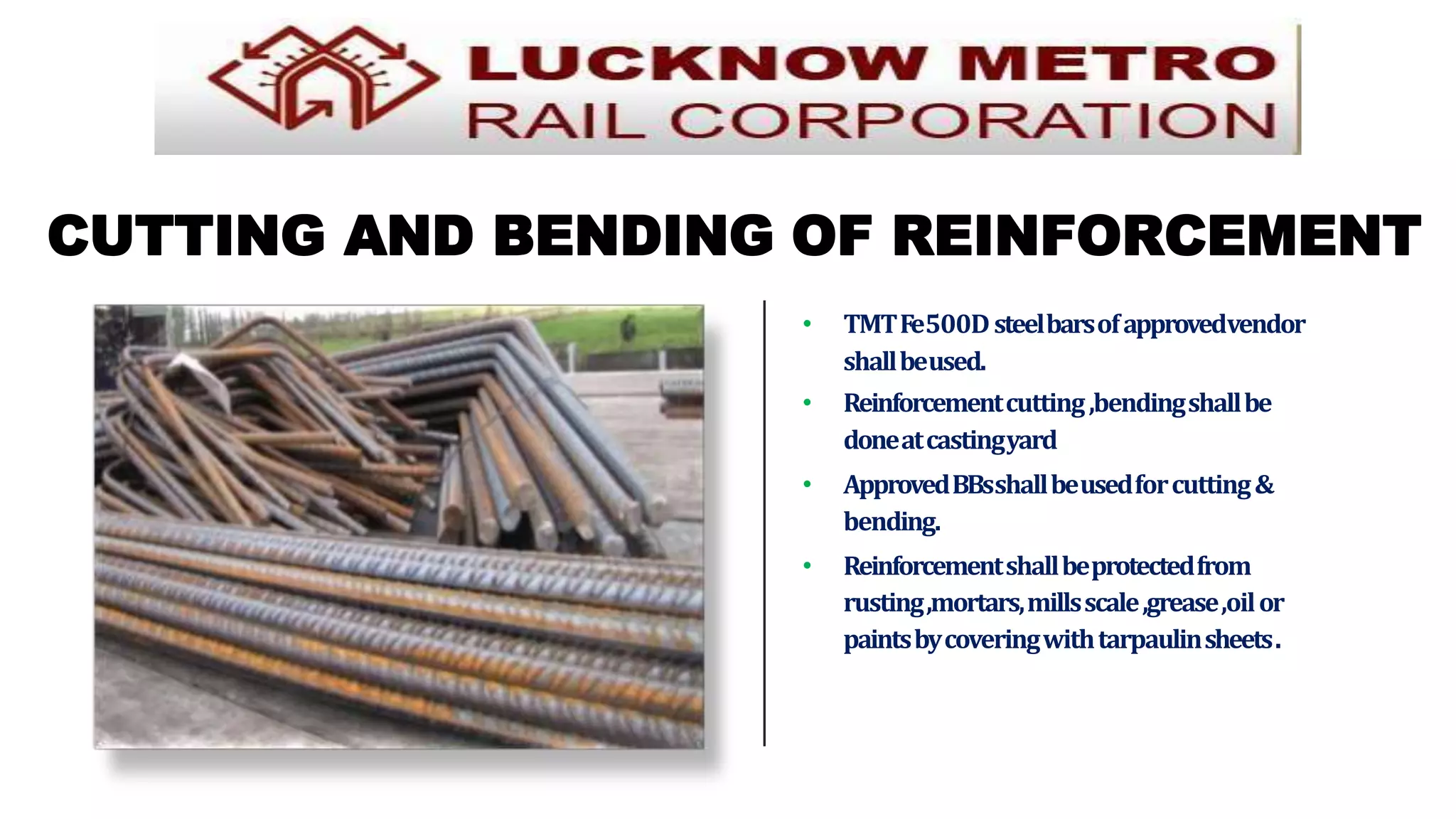

CUTTING AND BENDING OF REINFORCEMENT
• TMTFe500Dsteelbarsofapprovedvendor
shallbeused.
• Reinforcementcutting,bendingshallbe
doneatcastingyard
• ApprovedBBsshallbeusedforcutting&
bending.
• Reinforcementshallbeprotectedfrom
rusting,mortars,millsscale,grease,oilor
paintsbycoveringwithtarpaulinsheets.

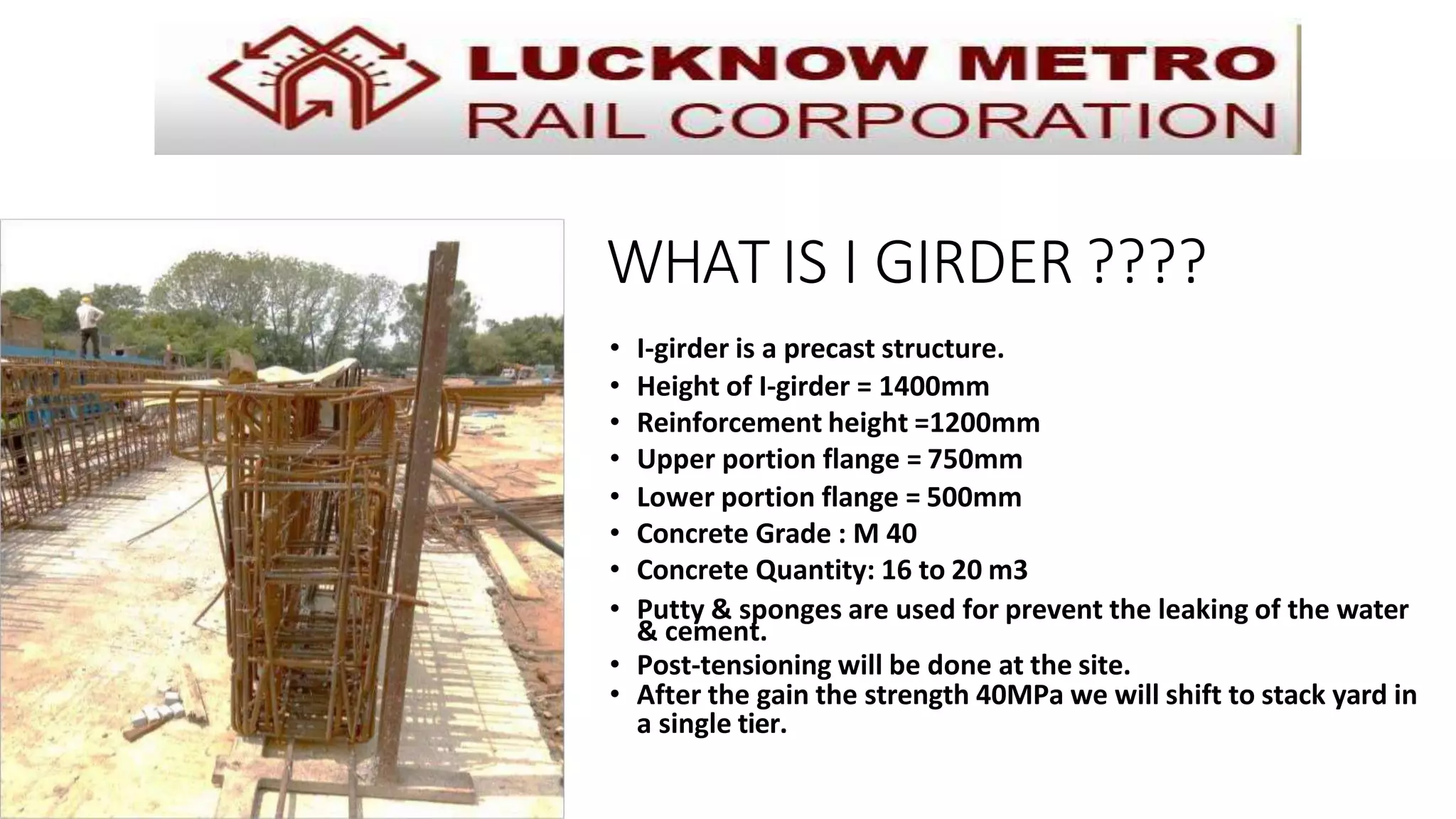

WHAT IS I GIRDER ????
• I-girder is a precast structure.
• Height of I-girder = 1400mm
• Reinforcement height =1200mm
• Upper portion flange = 750mm
• Lower portion flange = 500mm
• Concrete Grade : M 40
• Concrete Quantity: 16 to 20 m3
• Putty & sponges are used for prevent the leaking of the water
& cement.
• Post-tensioning will be done at the site.
• After the gain the strength 40MPa we will shift to stack yard in
a single tier.

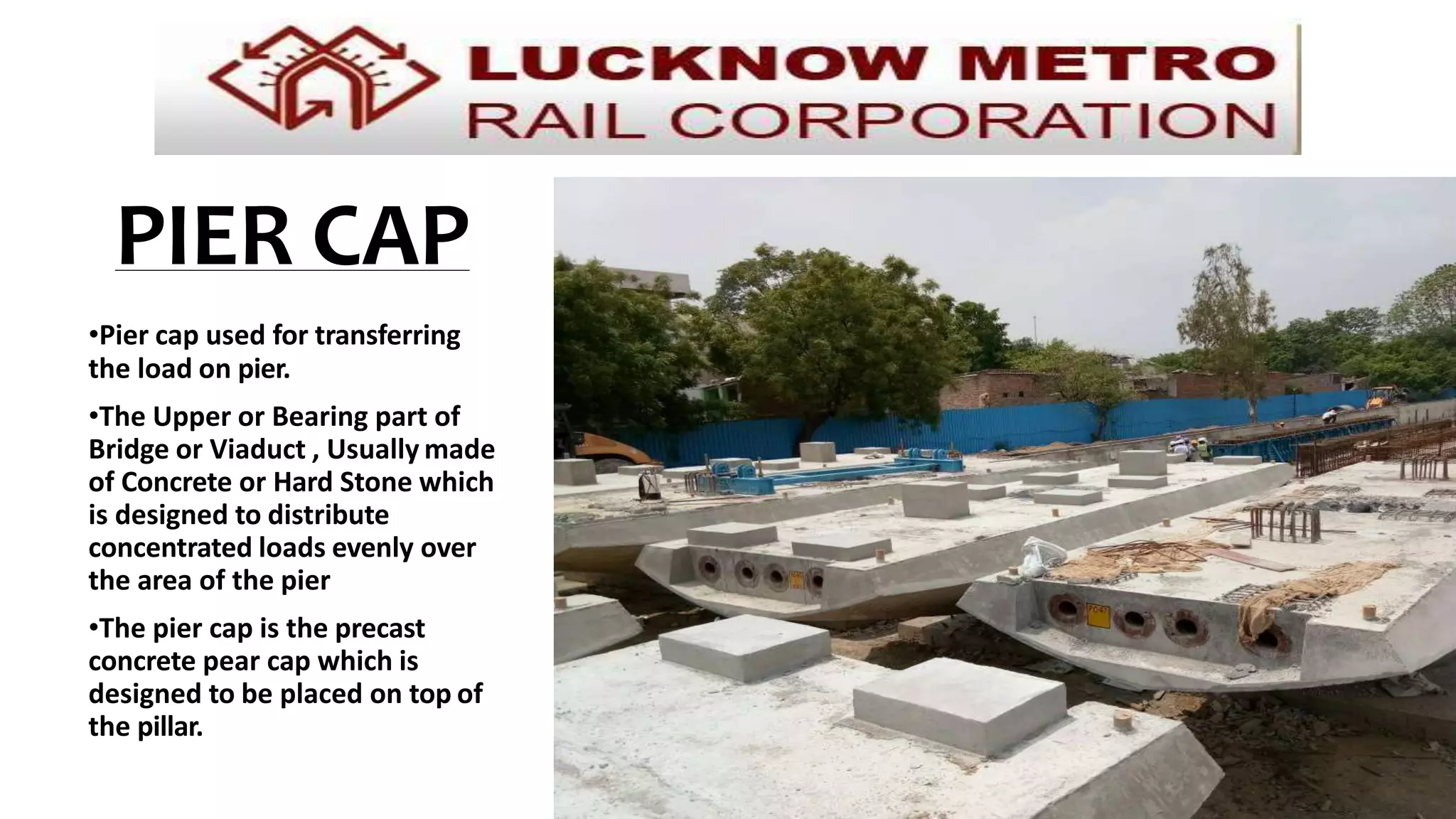

PIER CAP
•Pier cap used for transferring
the load on pier.
•The Upper or Bearing part of
Bridge or Viaduct , Usually made
of Concrete or Hard Stone which
is designed to distribute
concentrated loads evenly over
the area of the pier
•The pier cap is the precast
concrete pear cap which is
designed to be placed on top of
the pillar.
Length: 9200
mm ( Cover =
40mm)
Height : 2000
mm
Diameter of
Bars : 16 and
25mm
Concrete
Grade : M 45
Concrete
Quantity:
27.3 m3
The dia. of
sitting pipe is
124mm.
8 no. of
pedestals are
used for
placing of U-
girder.

TIME CYCLE FOR PIER CAP CASTING
PIER CAP CASTING= 74hrs
SHUTTER CLEANING = 4hrs
CAGE LOWERING = 2hrs
TO SHUTTER FIXING = 6 hrs
SHEATHING PROFILING AND END = 4hrs
SHUTTER FIXING = 4hrs
REBAR FIXING FOR SHEAR KEY = 4hrs
FINAL CHECKING = 1hrs
CONCRETING = 3hrs
STRENGTH GAIN = 48hrs
LIFTING AND STACKING = 2hrs

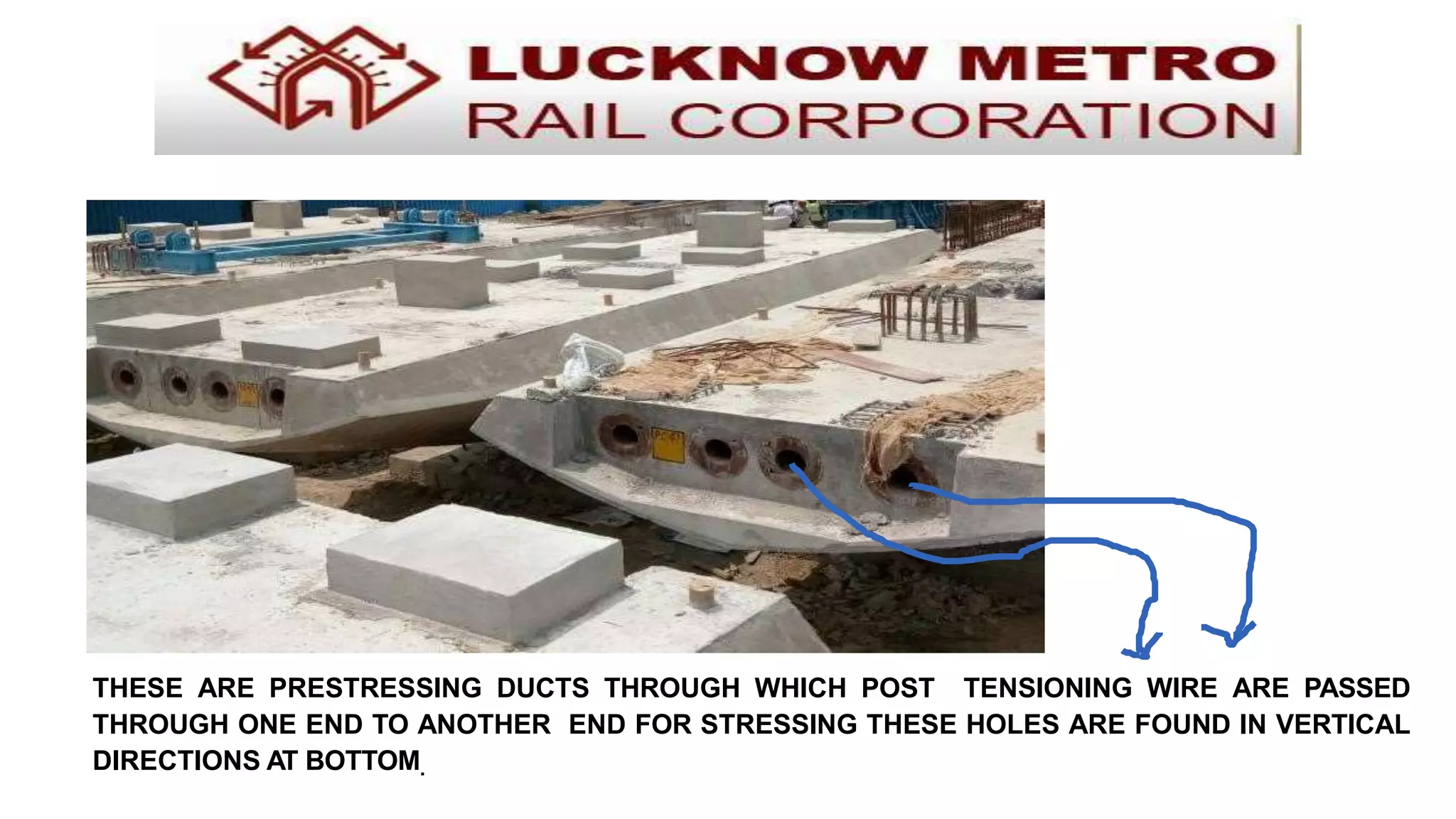

THESE ARE PRESTRESSING DUCTS THROUGH WHICH POST TENSIONING WIRE ARE PASSED
THROUGH ONE END TO ANOTHER END FOR STRESSING THESE HOLES ARE FOUND IN VERTICAL
DIRECTIONS AT BOTTOM.

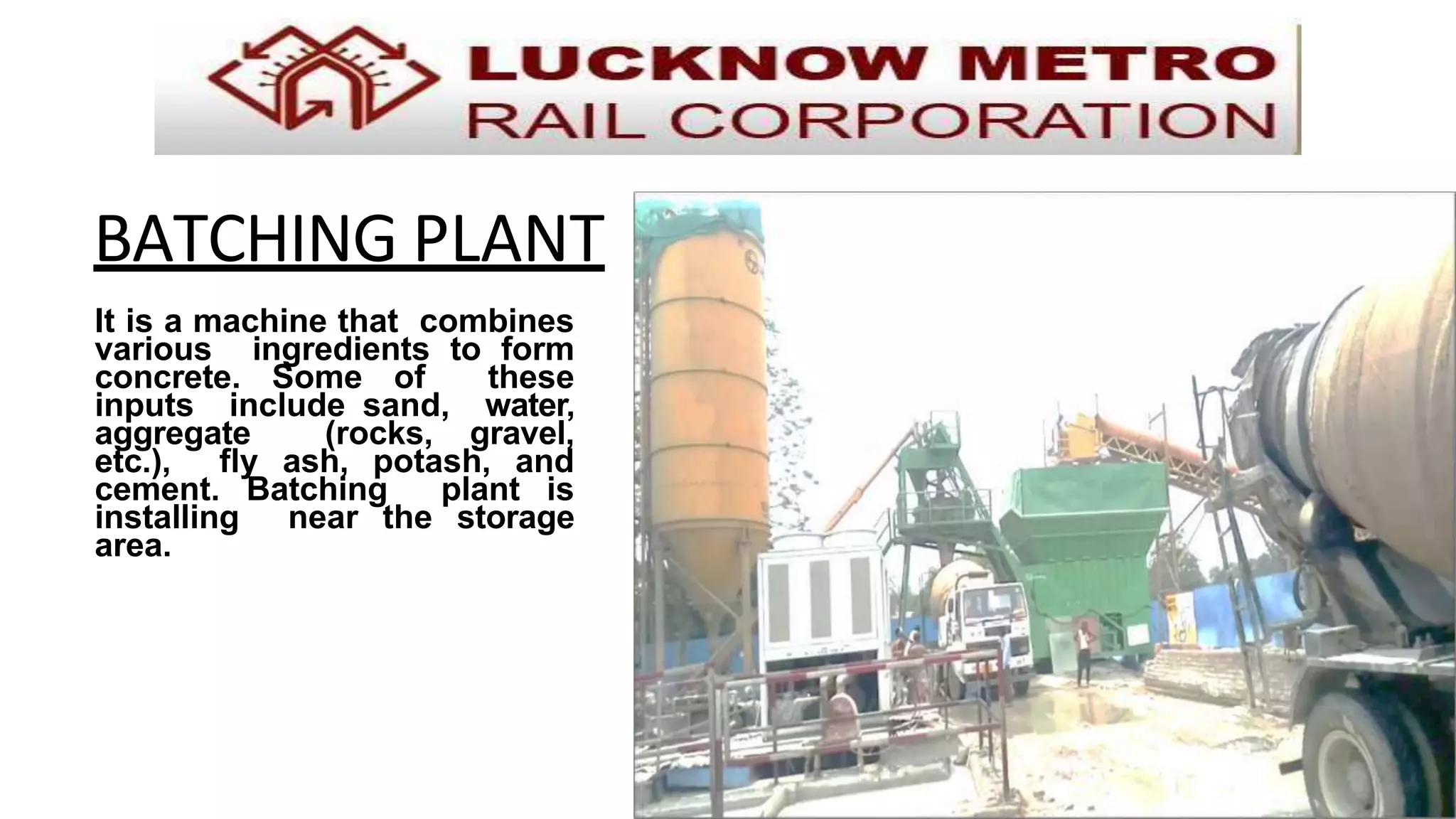

BATCHING PLANT
It is a machine that combines
various ingredients to form
concrete. Some of these
inputs include sand, water,
aggregate (rocks, gravel,
etc.), fly ash, potash, and
cement. Batching plant is
installing near the storage
area.
SPECIFICATION
• Storage-
 10mm aggregate
 20mm aggregate
 Crushed sand
 Cement storage (OPC grade 53)
• The materials are transport in mixture via bucket.
• The capacity of bucket is 1 cum.
• The capacity of mixture plant is 60 cum/hr.
• Mixing will be done in 35-45 sec.
• Two admixture are use in batching plant.-
• Cement retarder concrete admixture sodium gluconate.
(In 1%)
• Anti-corrosion admixture. (2.5%)

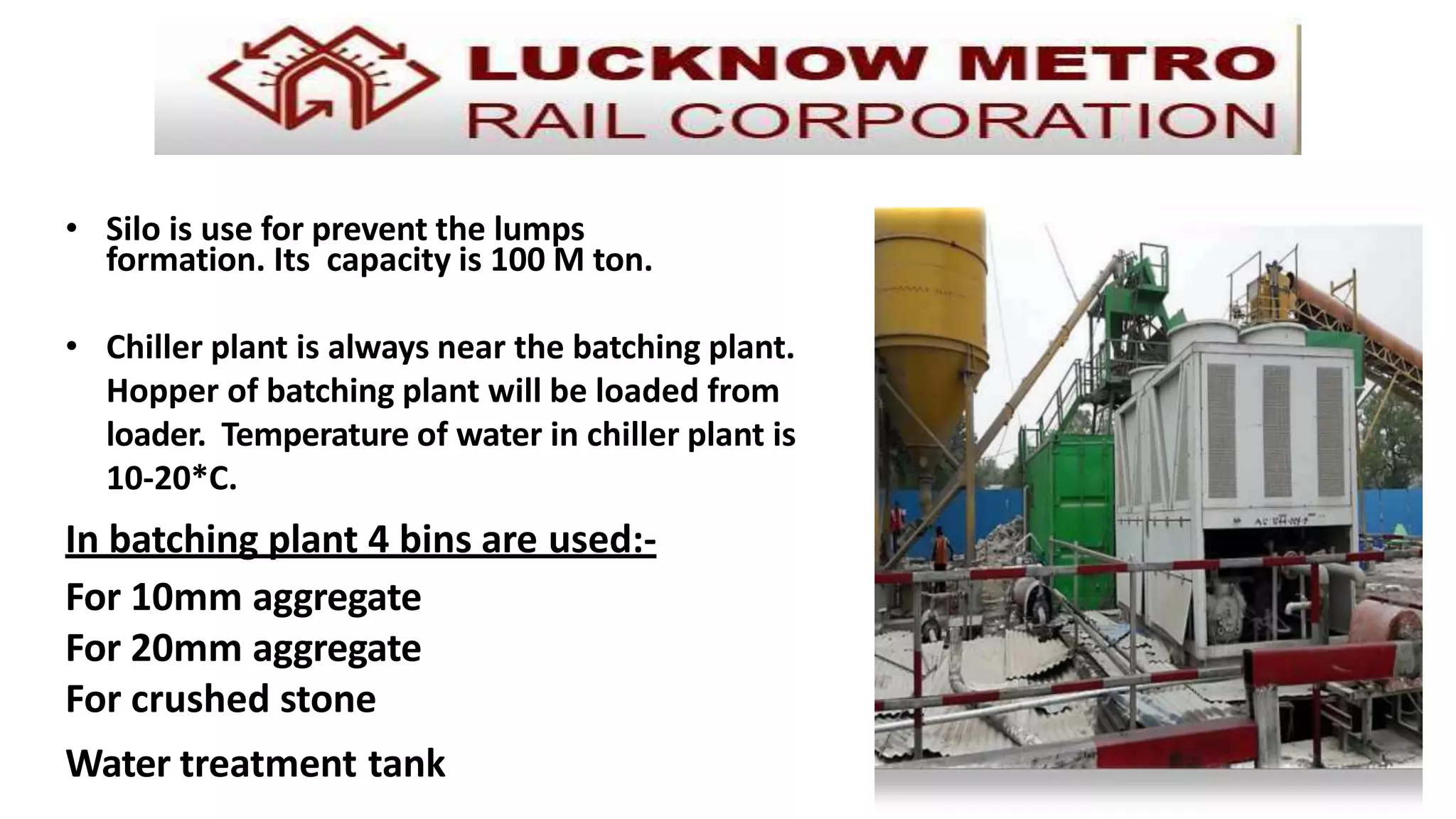

• Silo is use for prevent the lumps
formation. Its capacity is 100 M ton.
• Chiller plant is always near the batching plant.
Hopper of batching plant will be loaded from
loader. Temperature of water in chiller plant is
10-20*C.
In batching plant 4 bins are used:-
For 10mm aggregate
For 20mm aggregate
For crushed stone
Water treatment tank

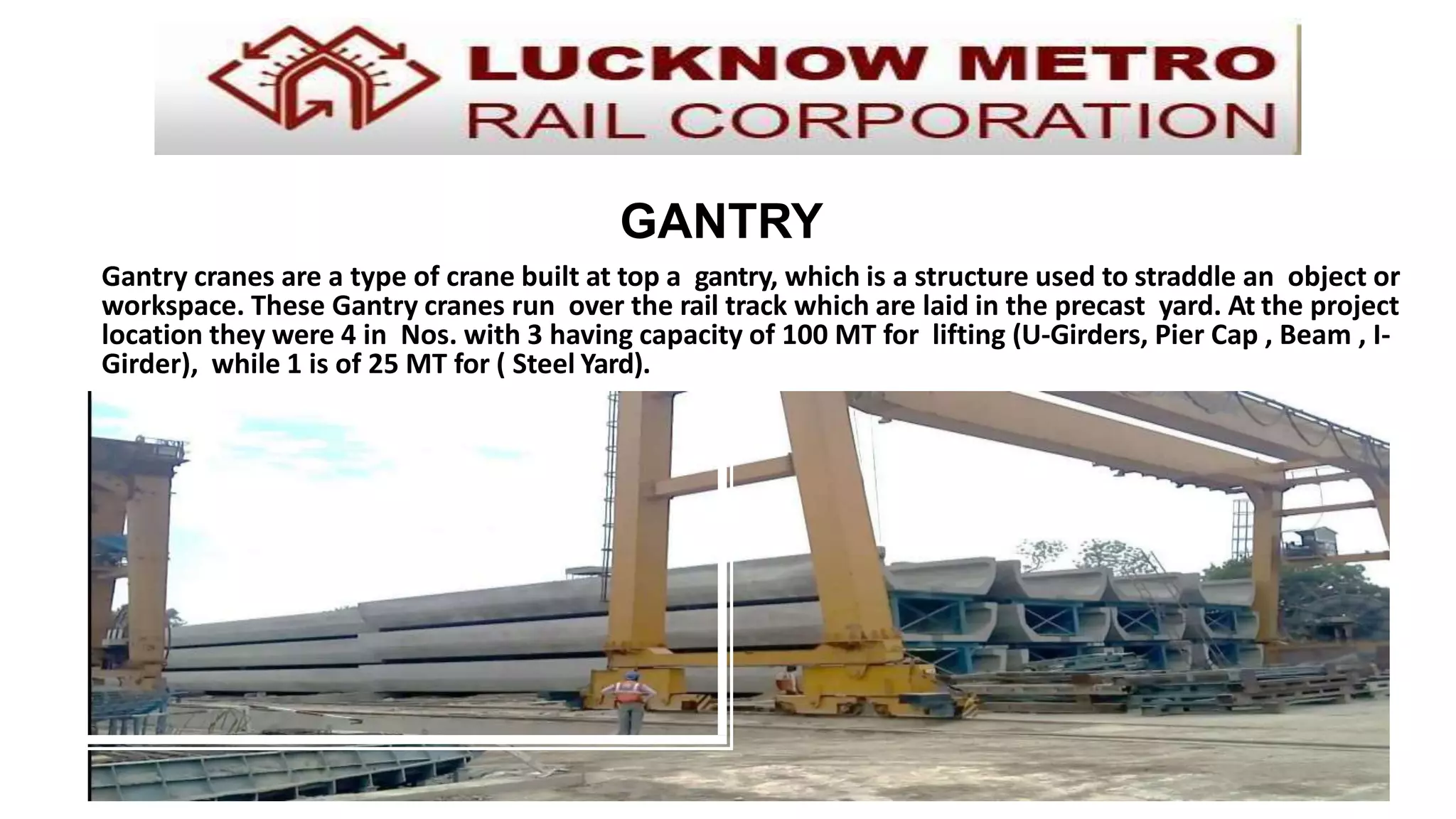

Gantry cranes are a type of crane built at top a gantry, which is a structure used to straddle an object or
workspace. These Gantry cranes run over the rail track which are laid in the precast yard. At the project
location they were 4 in Nos. with 3 having capacity of 100 MT for lifting (U-Girders, Pier Cap , Beam , I-
Girder), while 1 is of 25 MT for ( Steel Yard).
GANTRY

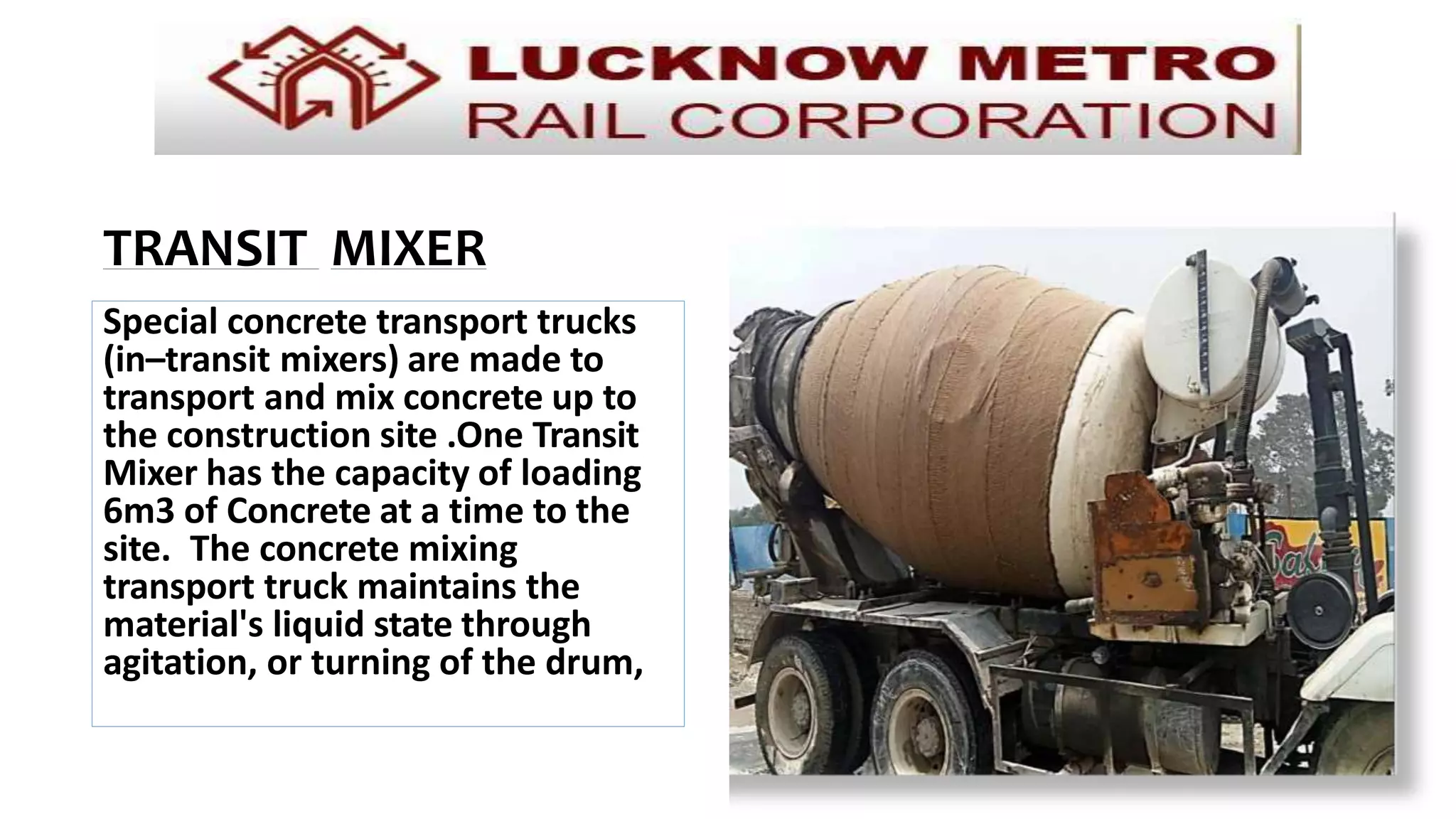

Special concrete transport trucks
(in–transit mixers) are made to
transport and mix concrete up to
the construction site .One Transit
Mixer has the capacity of loading
6m3 of Concrete at a time to the
site. The concrete mixing
transport truck maintains the
material's liquid state through
agitation, or turning of the drum,
until delivery.
TRANSIT MIXER

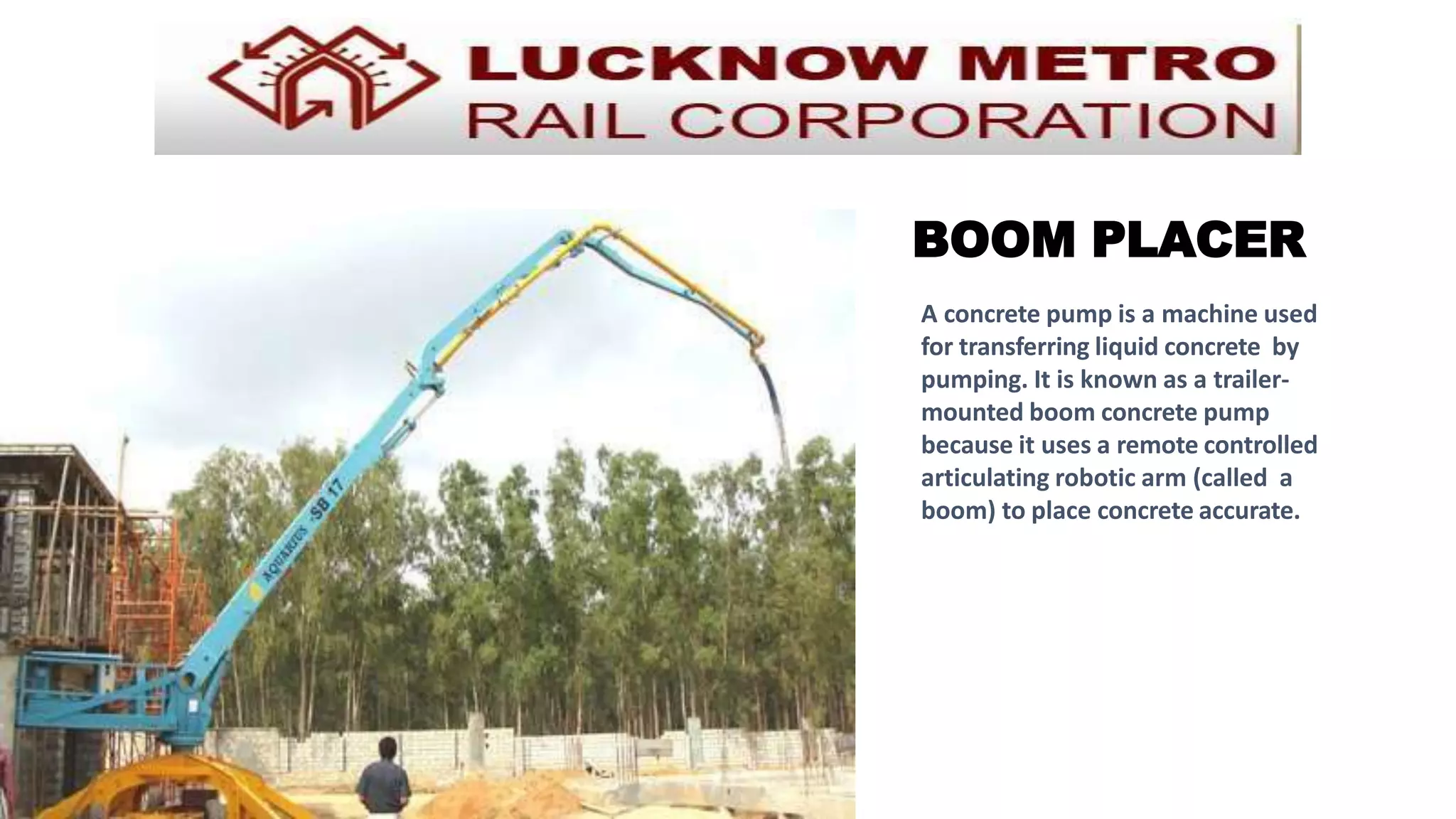

BOOM PLACER
A concrete pump is a machine used
for transferring liquid concrete by
pumping. It is known as a trailer-
mounted boom concrete pump
because it uses a remote controlled
articulating robotic arm (called a
boom) to place concrete accurate.
