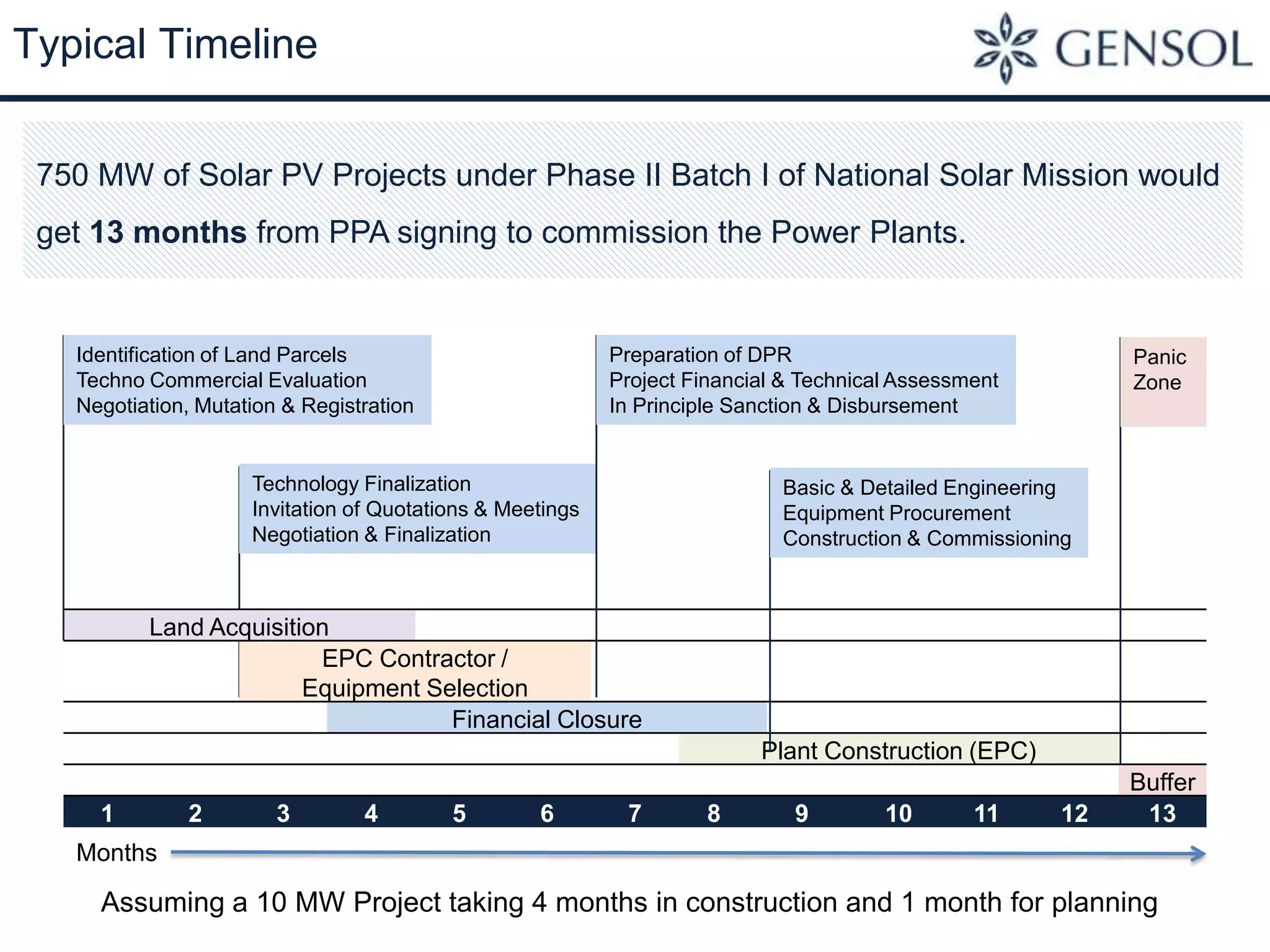

The document outlines the implementation timeline and processes for a solar PV project under India's National Solar Mission, detailing various phases from land acquisition to commissioning. It highlights potential delays related to engineering, procurement, and construction (EPC), emphasizing the importance of planning, permits, and managing equipment lead times. Additionally, it identifies common pitfalls and provides recommendations for ensuring timely project execution to mitigate financial losses.
