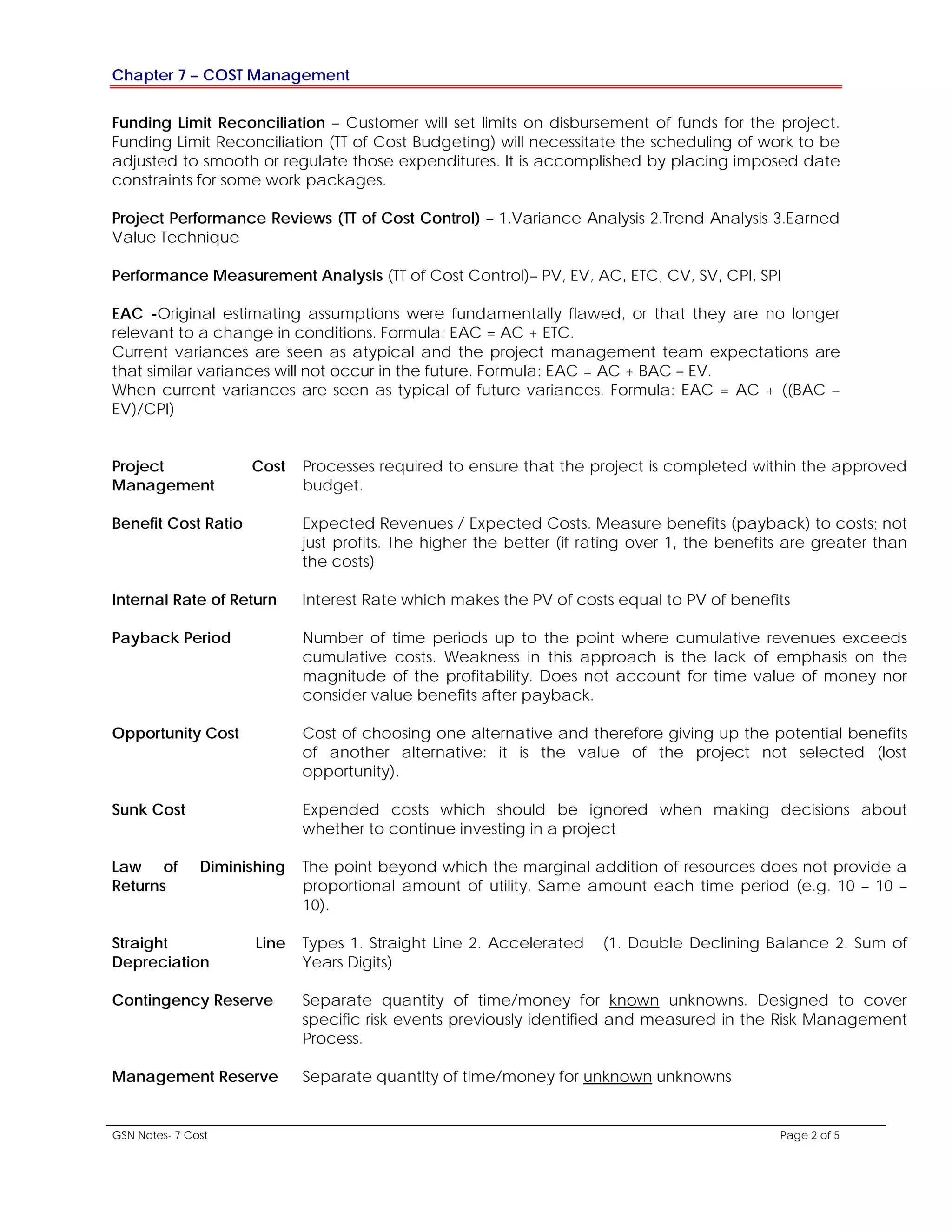

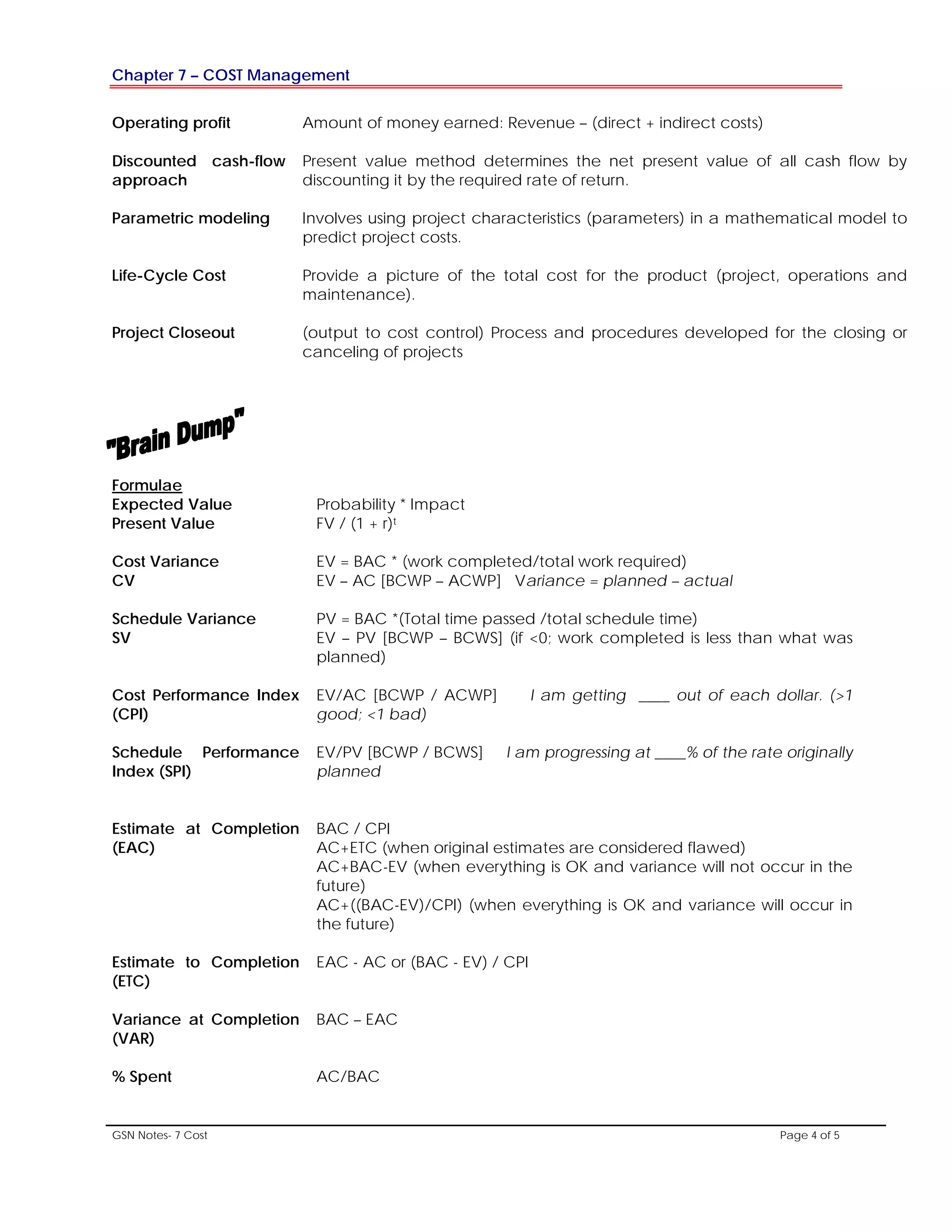

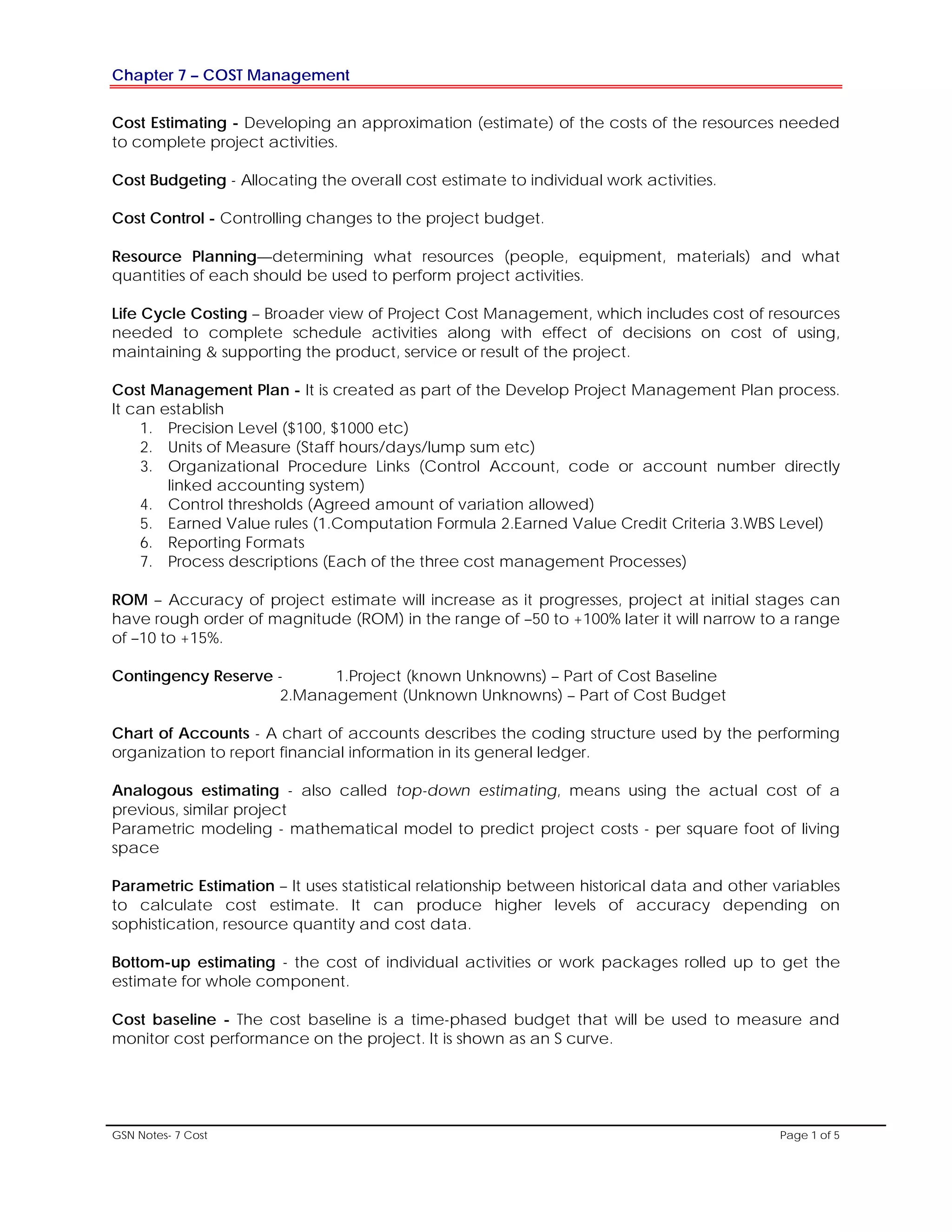

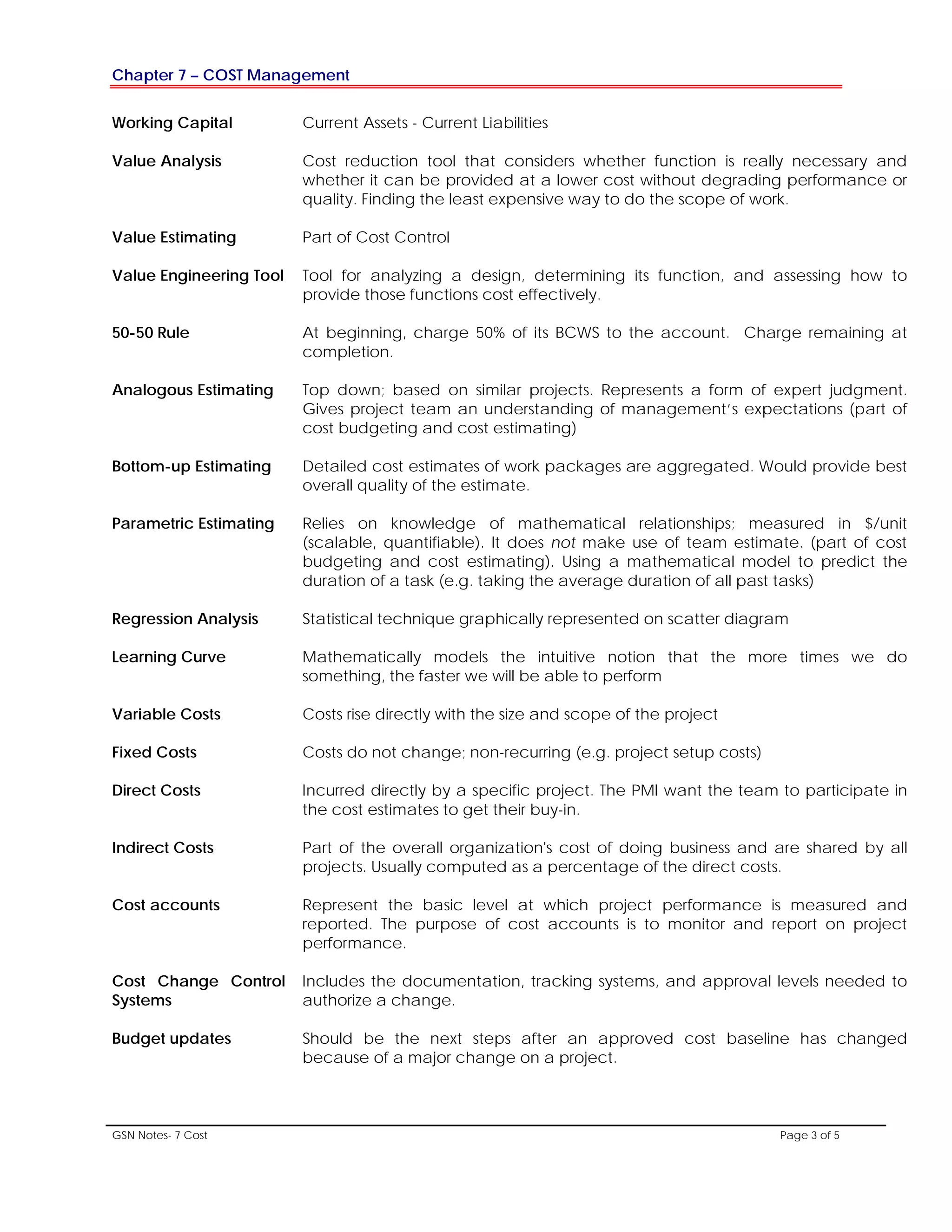

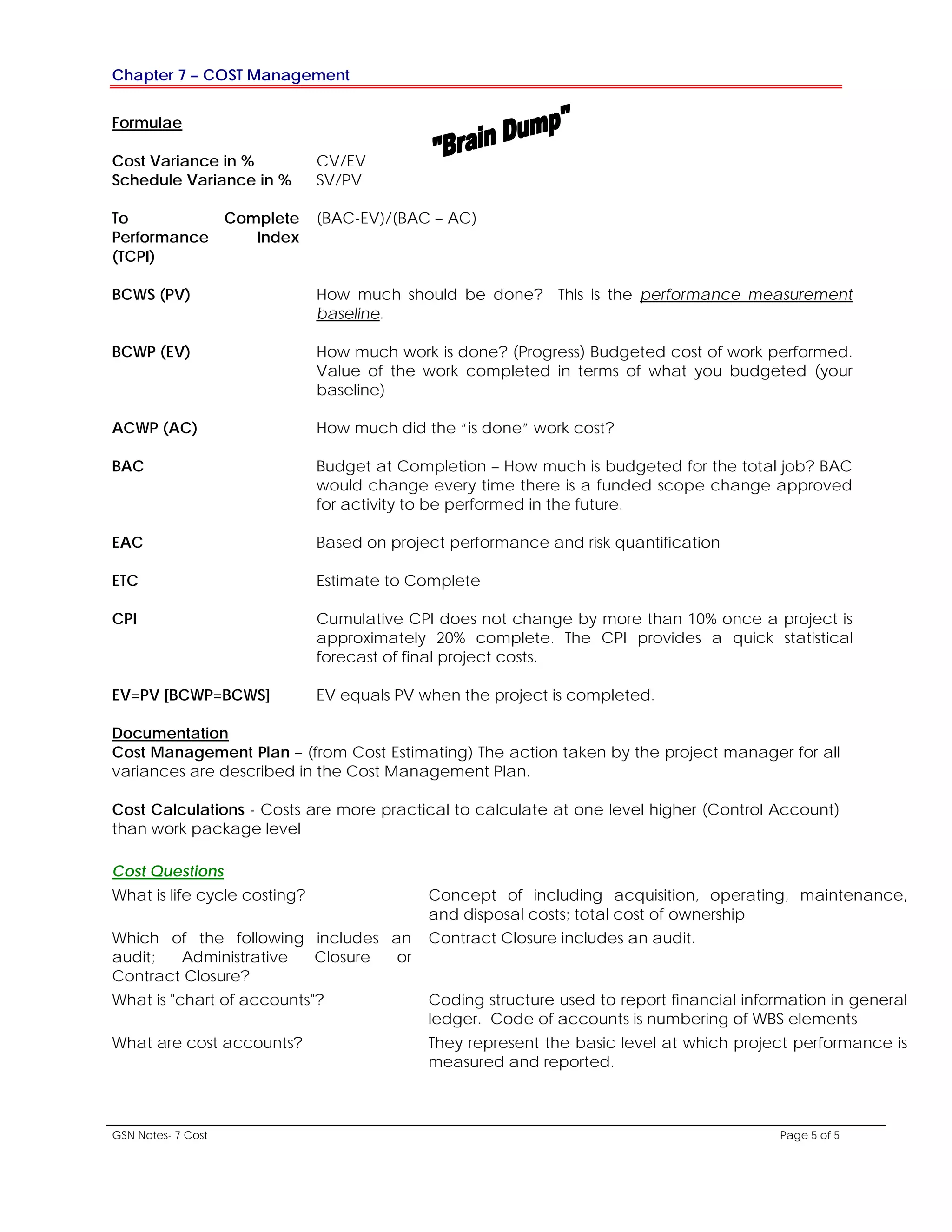

The document discusses key aspects of project cost management including cost estimating, budgeting, and control. It defines important terms like cost baseline, contingency reserve, estimate at completion (EAC), and performance indices. Formulas are provided for calculating things like cost variance, schedule variance, cost performance index, and estimate to completion. The cost management plan is highlighted as establishing guidelines for precision, units of measure, control thresholds, and reporting formats for cost activities.
