Project Cost Management
Dr. Panos FITSILIS
(fitsilis@teilar.gr)
Projects Make the Best of Scarce Resources
Developing a Project Budget
•Three major elements
–Forecast what will be needed
•Labor and material
–How much will it cost?
–When will it be needed?
•Thus, the budget reflects the project plan, time-phased, in dollars

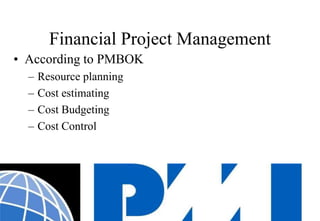

Financial Project Management
•According to PMBOK
–Resource planning
–Cost estimating
–Cost Budgeting
–Cost Control

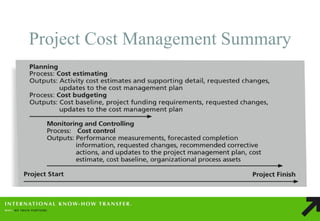

Project Cost Management Summary

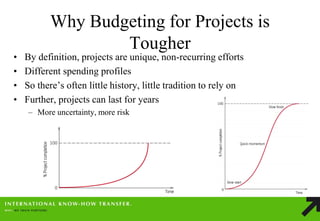

Why Budgeting for Projects is Tougher
•By definition, projects are unique, non-recurring efforts
•Different spending profiles
•So there’s often little history, little tradition to rely on
•Further, projects can last for years
–More uncertainty, more risk
Two Major Approaches to Budgeting
•Top-Down
•Bottom-Up
•Each has advantages . . . And disadvantages as well

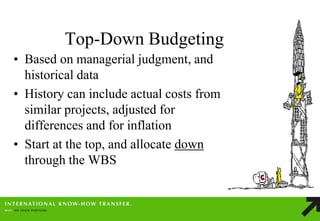

Top-Down Budgeting
•Based on managerial judgment, and historical data
•History can include actual costs from similar projects, adjusted for differences and for inflation
•Start at the top, and allocate down through the WBS
Bottom-Up Budgeting
•Starts at the bottom of the WBS, with the people who do the work
•Then costs are aggregated upward
•Overhead, project reserves, and profit have to be added in
Tools for Estimating (and Budgeting)
Top Down Estimating
Accuracy depends on experience
Fast, but estimates are rough
Bottom Up Estimating
Slow, but reliable
High cost (time) / WBS needed
Buy-in from the team
Parametric Modeling
Mathematical models to predict costs
Two types: REGRESSION ANALYSIS, and LEARNING CURVE
Delphi Method (analogous)
Expert judgment
Tasks need not to be identified
Considerable experience needed
A Format for Gathering Data on Project Resource Needs
Behavioral Issues in Budgeting
•Different perspectives, based on managerial level
–Senior people tend to underestimate, junior people tend to overestimate
–Lower levels tend to arbitrarily add reserves, upper levels to arbitrarily delete them
•Bottom Line: Any system can be gamed
•So know what the games are . . .

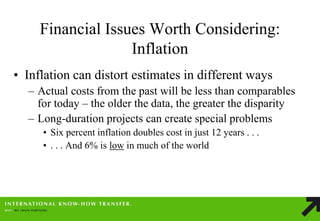

Financial Issues Worth Considering: Inflation
•Inflation can distort estimates in different ways
–Actual costs from the past will be less than comparables for today – the older the data, the greater the disparity
–Long-duration projects can create special problems
•Six percent inflation doubles cost in just 12 years . . .
•. . . And 6% is low in much of the world
Financial Issues Worth Considering: Learning Rate
•As output doubles, labor hours per unit decrease by a fixed percentage
•For example, the first unit of output takes 1,000 hours, and the learning rate is 80%
Unit
Labor hours req’d for that unit
1
1000
2
800
4
640
8
512

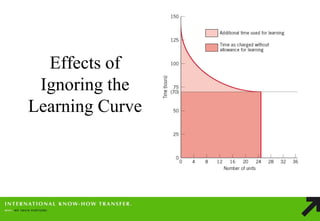

Effects of Ignoring the Learning Curve

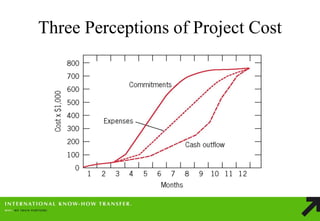

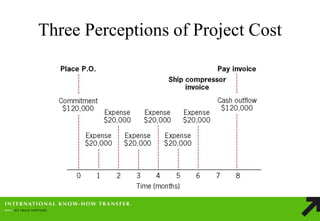

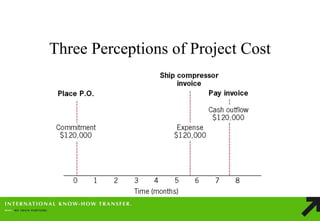

Three Perceptions of Project Cost
Three Perceptions of Project Cost
Three Perceptions of Project Cost
Cost Types
•Direct Costs Related “Directly” to the project ex. Labor hours, material, equipment, food, travel. . .
•Indirect Costs Overhead used for more than one project ex. Building rent, taxes, janitorial services

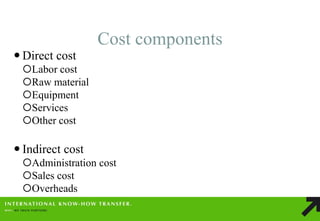

Cost components
Direct cost
Labor cost
Raw material
Equipment
Services
Other cost
Indirect cost
Administration cost
Sales cost
Overheads
Cost Types
A cost by any other name, really isn’t the same!
•Variable Cost – Changes with volume
•Fixed Cost – Stay the same, regardless of volume
COST
Volume
TC = VC+FC
VC
FC

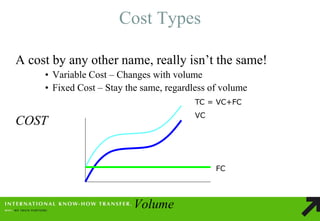

Cost Types

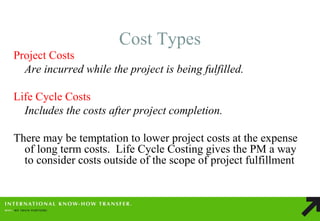

Project Costs
Are incurred while the project is being fulfilled.
Life Cycle Costs
Includes the costs after project completion.
There may be temptation to lower project costs at the expense of long term costs. Life Cycle Costing gives the PM a way to consider costs outside of the scope of project fulfillment

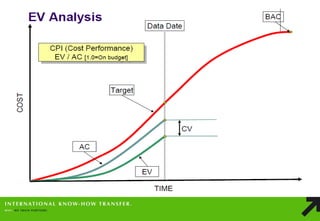

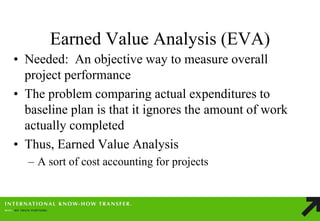

Earned Value Analysis (EVA)
Earned Value Analysis (EVA)
•Needed: An objective way to measure overall project performance
•The problem comparing actual expenditures to baseline plan is that it ignores the amount of work actually completed
•Thus, Earned Value Analysis
–A sort of cost accounting for projects

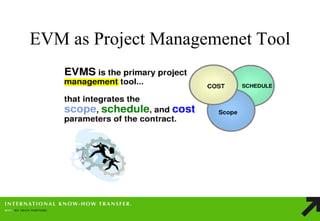

EVM as Project Managemenet Tool

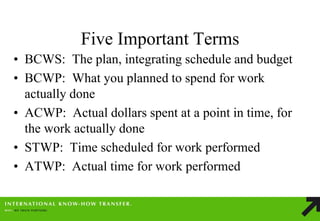

Five Important Terms
•BCWS: The plan, integrating schedule and budget
•BCWP: What you planned to spend for work actually done
•ACWP: Actual dollars spent at a point in time, for the work actually done
•STWP: Time scheduled for work performed
•ATWP: Actual time for work performed

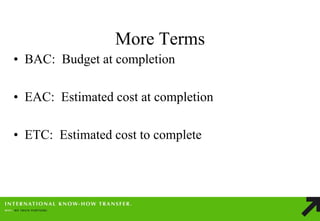

More Terms
•BAC: Budget at completion
•EAC: Estimated cost at completion
•ETC: Estimated cost to complete

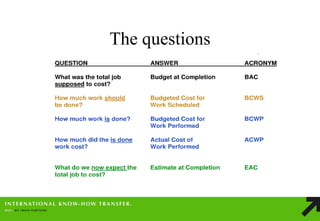

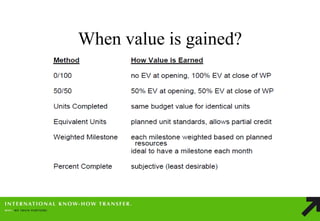

When value is gained?
The questions

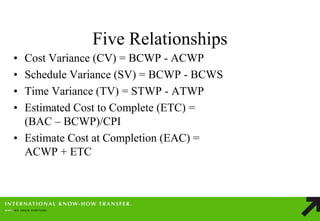

Five Relationships
•Cost Variance (CV) = BCWP - ACWP
•Schedule Variance (SV) = BCWP - BCWS
•Time Variance (TV) = STWP - ATWP
•Estimated Cost to Complete (ETC) = (BAC – BCWP)/CPI
•Estimate Cost at Completion (EAC) = ACWP + ETC

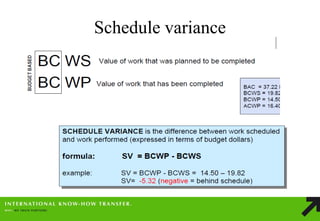

Schedule variance

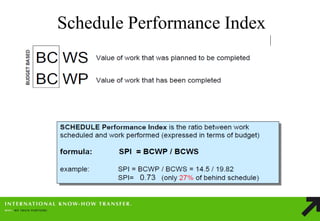

Schedule Performance Index
Cost Variance
Cost Performance Index

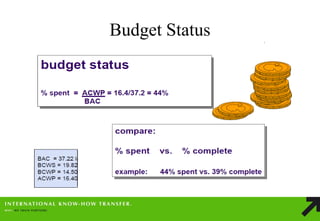

Budget Status

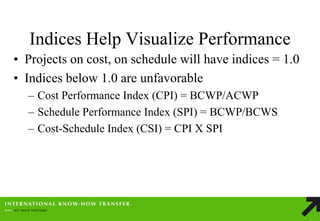

Indices Help Visualize Performance
•Projects on cost, on schedule will have indices = 1.0
•Indices below 1.0 are unfavorable
–Cost Performance Index (CPI) = BCWP/ACWP
–Schedule Performance Index (SPI) = BCWP/BCWS
–Cost-Schedule Index (CSI) = CPI X SPI
Possible Arrangements
Possible Arrangements
Example
•Assume a work package expected to be finished today, at cost of $1500. But you’re only 2/3 complete, and you’ve spent $1350.
•CPI = BCWP/ACWP = $1000/$1350 = .74
•SPI = BCWP/BCWS = $1000/$1500 = .67
•CSI = CPI/SPI = .74 X .67 = .49

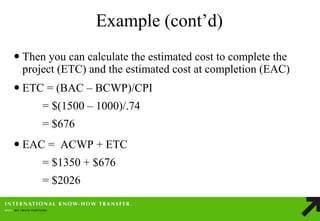

Example (cont’d)
Then you can calculate the estimated cost to complete the project (ETC) and the estimated cost at completion (EAC)
ETC = (BAC – BCWP)/CPI = $(1500 – 1000)/.74 = $676
EAC = ACWP + ETC = $1350 + $676 = $2026
Thank you!
