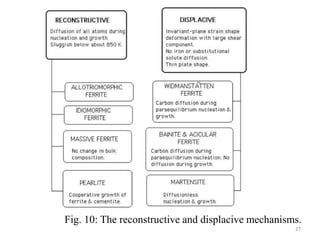

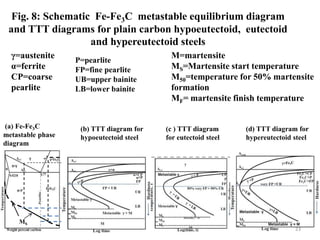

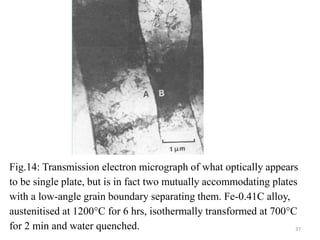

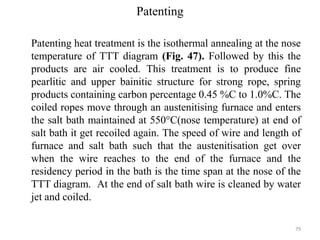

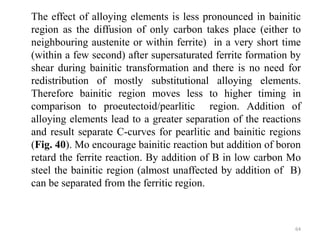

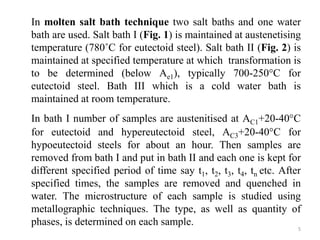

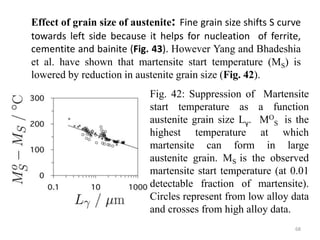

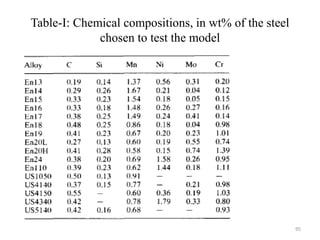

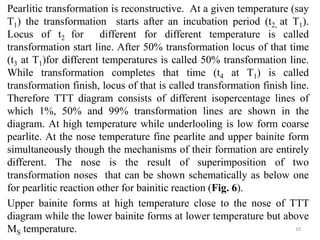

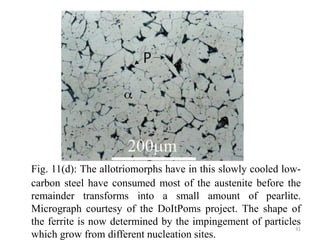

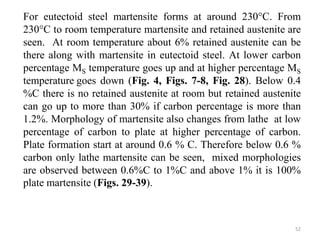

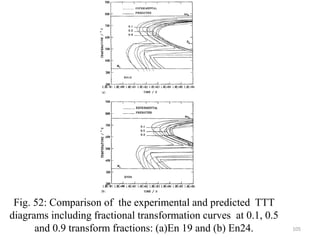

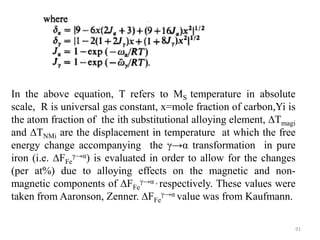

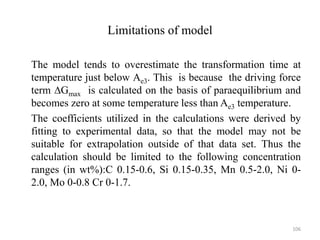

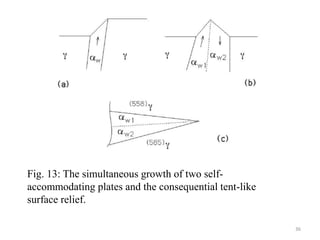

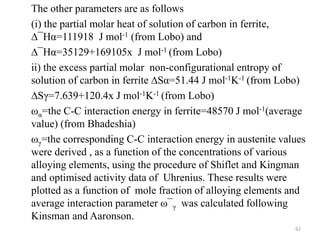

TTT diagrams provide information about the kinetics of isothermal phase transformations in steels by plotting the time and temperature required for certain phase transformations. They are determined experimentally using techniques like salt bath treatment followed by metallography. The TTT diagram for eutectoid steel shows the temperature and time required for the formation of pearlite, bainite, and martensite. The shape of the diagram and the positions of phases depends on factors like the steel's carbon content and alloying elements. TTT diagrams give insight into the transformation mechanisms and resulting microstructures at different cooling conditions.
