1
University of Thi-Qar
College of Engineering
Mechanical Engineering Department
"Theoretical study about Tidal Energy"

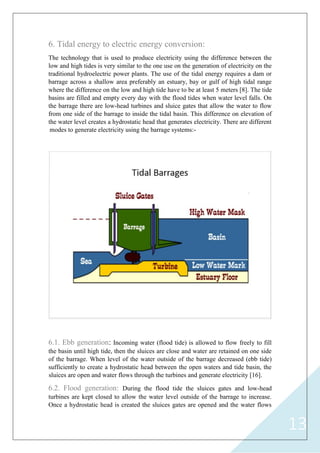

By
Balqees Hmode Abdullah
Supervised by
Asst. Prof. Dr.Mushtaq I. Hasan
2
Abstract
This article is about tidal power. It describes tidal power

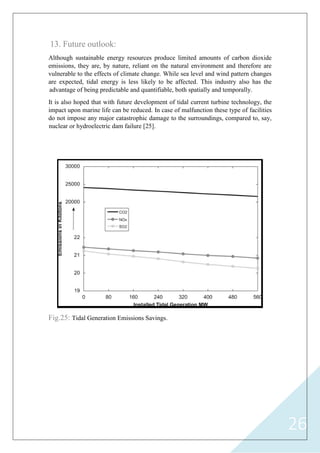

and the various methods of utilizing tidal power to
generateelectricity. It briefly discusses each method

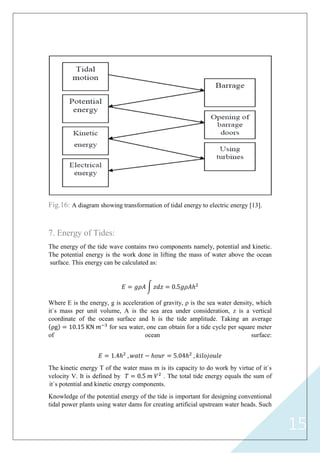

and provides details of calculating tidal power generation
and energy most effectively. The paper also focuses
on the potential this method of generating
electricity has and why this could be a common

way of producing electricity in the near future.

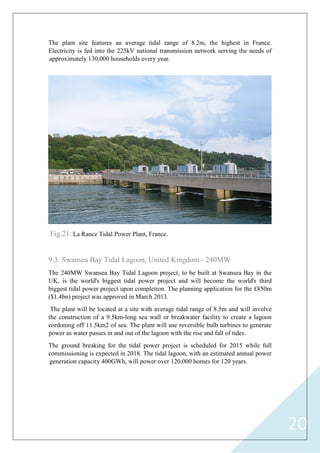

3
1. Overview:

Tidal power exploits energy drawn from the movement of ocean tides to
produce electricity. There are two scenarios in which tides can be tapped for
energy. The first is in changing sea levels. This phenomenon is responsible for
the advancing and receding tides on shorelines. With the help of turbines,
incoming tides can be manipulated to generate electricity. The second way to
exploit tidal energy is by sinking turbines to the sea floor where fast-flowing

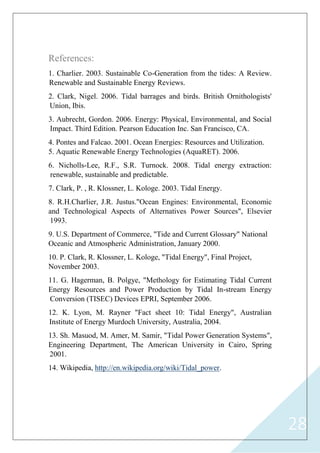

currents turn generator blades much like wind does with a wind turbine.
Tidal energy is considered renewable because the tides move on a predictable,
daily schedule, depending only on the orbits of the Earth, Moon, and Sun, and
are essentially inexhaustible [1]. Though tidal energy is carbon free, it is not
environmentally benign. Concerns over the health of shoreline and aquatic
ecosystems mar this otherwise clean source of energy. Older tidal barrage
technology can devastate fish populations [2].
In the past, large-scale barrage systems dominated the tidal power scene. But
because of increasingly evident unfavorable environmental and economic
drawbacks with this technology, research into the field of tidal power shifted
from barrage systems to tidal current turbines in the last few decades. This
new technology leaves a smaller environmental footprint than tidal barrages,
as turbines are placed in offshore currents avoiding the need to construct dams
to capture the tides along ecologically fragile coastlines. Harnessing tidally-
driven coastal currents cannot yet deliver the sheer amount of power that
barrage style facilities can, like at the 240 MW barrage generating station at
La Rance, France [3]. However, the technology is quickly evolving with
numerous test plants popping up around the globe.
Canada hosts two test sites, one tidal barrage and one tidal current power
station. With one new and one old, both a history and a newfound interest in
tidal power is apparent. The Annapolis Royal tidal barrage built in Nova
Scotia's Bay of Fundy in 1984, with its world-famous tides, operates as the
third largest tidal power plant in the world, with 20 MW [4]. The smaller Race
Rocks facility in British Columbia, installed in 2006, uses tidal current
technology to generate 65 kW of power [5]. Studies have estimated a potential
4,000 MW of untapped energy flowing along the coasts of BC [6]. Canada,
and the shores of British Columbia, are home to some of the world's most
attractive locations for tidal power development.
4
2. Brief History of Tidal Power:
The energy stored in tides been known to people for many centuries. The earliest
records of tidal mills are dated back to the 8th Century CE [7]. The tidal mills were
mainly used for grain grinding and were of similar design to the conventional water
mills with the exception of the addition of a dam and reservoir. The industrial
revolution increased demand for power but tidal energy never got off the ground,
undercut by cheap fossil fuels and other developments which offered easier access to
power generation. Existing tidal mills became as obsolescent as pre-industrial water-
mills. The first large scale modern tidal electric plant started to operate in La Rance
Estuary, St. Malo, France in the 1960s and has been operating ever since. In recent
years the search for renewable, non-polluting energy sources and the increase in fossil
fuel prices has encouraged renewed interest in tidal power.
3. Tides:
The interaction of the sun-moon-earth system causes ones of the strangest
phenomena: tides. Tides rise and fall is the product of the gravitational and centrifugal
forces, of primarily the moon with the earth. The gravitational forces maintain the
moon on it is positions with respect to the earth, forcing to pull the earth and the moon
together, see figure 1. The centrifugal forces acts on the opposite direction pulling the
moon away from the earth. These two forces acts together to maintain the equilibrium
between these two masses.
The influence of the sun can be included on the balance of the entire system. The
distance plays an important role on the development of tides. Based on the newton
law, the gravitational force is proportional to the square of the distance of two bodies,
but tidal force is proportional to the cube of the distance. For this reason although the
5
moon has a much smaller mass than the sun it is much closer to the earth. The moon
effect is 2
1
4
greater than that of the sun on the generation of tides [8].
The gravitational force of attraction of the moon causes that the oceans waters bulge
on the side of the earth that faces the moon. The centrifugal force produce the same
effect but in the opposite side of the earth. On these two sides it can be observe the
maximum amplitudes of the tides (high tides) and on midways of it occur the
minimum amplitudes of the tides (low tides). As the earth rotates these two bulges
travel at the same rate as the earth`s rotation. The moon rotates around the earth with
respect to the sun approximately 29.5 days (lunar month) in the same direction that
the earth rotates every 24 hours. The rotation of the earth with respect to the moon is
approximately 24.48 hours (24 hours and 50 minutes) and is called lunar day. This is
the reason of why the tides advance approximately 50 minutes each day [9].

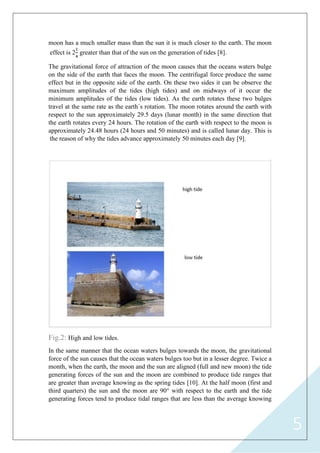

Fig.2: High and low tides.
In the same manner that the ocean waters bulges towards the moon, the gravitational
force of the sun causes that the ocean waters bulges too but in a lesser degree. Twice a
month, when the earth, the moon and the sun are aligned (full and new moon) the tide
generating forces of the sun and the moon are combined to produce tide ranges that
are greater than average knowing as the spring tides [10]. At the half moon (first and
third quarters) the sun and the moon are 90° with respect to the earth and the tide
generating forces tend to produce tidal ranges that are less than the average knowing
6

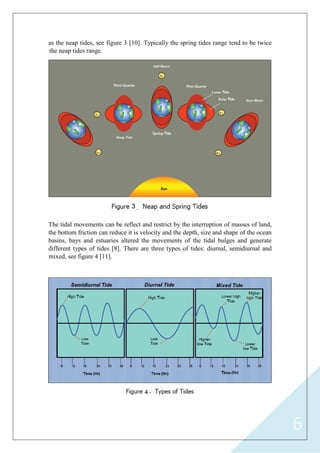

as the neap tides, see figure 3 [10]. Typically the spring tides range tend to be twice
the neap tides range.
The tidal movements can be reflect and restrict by the interruption of masses of land,
the bottom friction can reduce it is velocity and the depth, size and shape of the ocean
basins, bays and estuaries altered the movements of the tidal bulges and generate

different types of tides [8]. There are three types of tides: diurnal, semidiurnal and
mixed, see figure 4 [11].
7
Diurnal tides (daily) present one single high and low water during a period of a lunar
day of 24 hours and 50 minutes and occur in the Gulf of Mexico, southeast Asia and
the coast of Korea, semidiurnal tides (twice a day) present two high an two low waters
during a lunar day with periods of 12 hours and 50 minutes and is common along the
Atlantic coast of North America and the mixed tides that presents two unequal high
and two unequal lows waters and generally have a periods of 12 hours and 50
minutes. In a lunar month this type of tide that is common on the pacific Ocean coast
of the United states can experience semidiurnal and diurnal tides characteristics. In
1964 Davis classified the tidal ranges as: micro-tidal with tidal range less than 2
meters, meso-tidal with tidal range between 2 and 4 meters and macro-tidal with tidal
range of more than 4 meters [12].
4. How Tidal Power Generation Systems Work?
In very simple terms a barrage is built at the entrance of a gulf and the water levels
vary on both sides of the small dam. Passages are made inside the dam and water
flows through these passages and turbines rotate due to this flow of water under head
of water. Thus, electricity is created using the turbines. A general diagram of the
system is shown in Fig 5. What follows will be a description of a general tidal power
station with its components. Also, many systems of power generation will be
described.

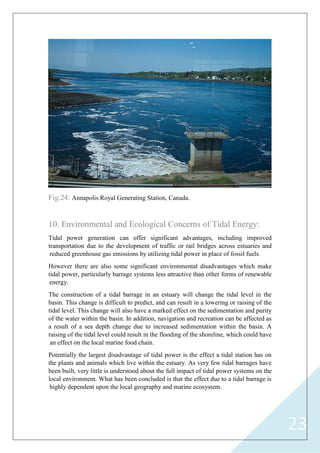

General scheme of the tidal power station.Fig.6:
The components of a tidal power station are:
4.1. A barrage: a barrage is a small wall built at the entrance of a gulf in order to
trap water behind it. It will either trap it by keeping it from going into the gulf when
water levels at the sea are high or it will keep water from going into the sea when
water level at the sea is low.
8
4.2. Turbines: they are the components responsible for converting potential energy
into kinetic energy. They are located in the passageways that the water flows through
when gates of barrage are opened. There are many types of turbines used in tidal
power stations.

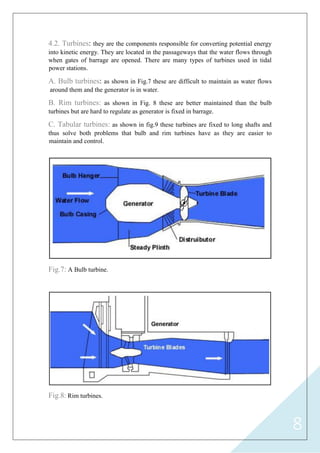

A. Bulb turbines: as shown in Fig.7 these are difficult to maintain as water flows
around them and the generator is in water.
B. Rim turbines: as shown in Fig. 8 these are better maintained than the bulb
turbines but are hard to regulate as generator is fixed in barrage.
C. Tabular turbines: as shown in fig.9 these turbines are fixed to long shafts and
thus solve both problems that bulb and rim turbines have as they are easier to
maintain and control.
Fig.7: A Bulb turbine.
Fig.8: Rim turbines.
9

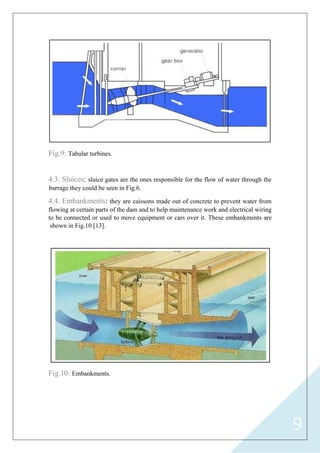

Fig.9: Tabular turbines.
4.3. Sluices: sluice gates are the ones responsible for the flow of water through the
barrage they could be seen in Fig.6.
4.4. Embankments: they are caissons made out of concrete to prevent water from
flowing at certain parts of the dam and to help maintenance work and electrical wiring
to be connected or used to move equipment or cars over it. These embankments are
shown in Fig.10 [13].
Fig.10: Embankments.
10
5. Tidal Energy Generators:
There are currently three different ways to get tidal energy which are:
5.1. Tidal Fences:
Tidal fences are composed of individual, vertical axis turbines which are mounted
within the fence structure, known as a caisson. Kind of like giant turn styles which
completely block a channel, forcing all of the water through them. Unlike barrage
tidal power stations, tidal fences can also be used in unconfined basins, such as in the
channel between the mainland and a nearby off shore island, or between two islands.
Since they do not require flooding of the basin, tidal fences have much less impact on
the environment, and are significantly cheaper to install. Unlike barrage generators,
tidal fences have the advantage of being able to generate electricity once the initial
modules are installed [14].
Fig.11: Tidal fences.
5.2. Tidal lagoons:
Tidal lagoons are an adaptation of the barrage system. Similar to standard barrage
models, tidal lagoons retain a head pond and generate power via conventional hydro-
turbines.
The difference is that the conventional barrage designs exploit the natural coast line to
11
minimize barrage length. However, this entails blocking the estuary regardless of how
deep it is. This raise the costs considerably. However, a lagoon, for a low cost can
pretty much be built anywhere that there is a high tidal range. The lagoon has
relatively little visual impact, as it is below the high water tide mark and appears like
a normal sea wall at low tide.
The lagoon can be built using loose aggregates found in quarries or demolished
structures. This rubble would be „dumped‟ until an impound wall was complete. As
any aggregate can be used, it is possible to restrict construction costs by implementing
the cheapest materials available. This construction technique also has the added
benefit of creating an artificial reef. As well, a calm water lake would be created in
the middle where smaller fish and birds could flourish. Migrating fish can swim
around unimpeded and without the danger of sluices or negotiating turbines [14].

Fig.12: Tidal lagoons.
5.3. Tidal Turbines

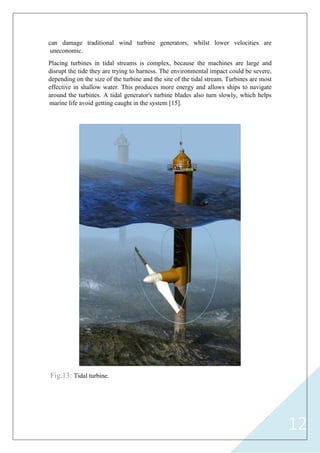

For most tidal energy generators, turbines are placed in tidal streams. A tidal stream is
a fast-flowing body of water created by tides. A turbine is a machine that takes energy
from a flow of fluid. That fluid can be air (wind) or liquid (water). Because water is
much more dense than air, tidal energy is more powerful than wind energy. Unlike
wind, tides are predictable and stable. Where tidal generators are used, they produce a
steady, reliable stream of electricity.
Tidal turbines utilize tidal currents that are moving with velocities of between 2 and 3
m/s (4 to 6 knots) to generate between 4 and 13 kW/m2. Fast moving current (>3 m/s)
can cause undue stress on the blades in a similar way that very strong gale force winds
12
can damage traditional wind turbine generators, whilst lower velocities are
uneconomic.
Placing turbines in tidal streams is complex, because the machines are large and
disrupt the tide they are trying to harness. The environmental impact could be severe,
depending on the size of the turbine and the site of the tidal stream. Turbines are most
effective in shallow water. This produces more energy and allows ships to navigate
around the turbines. A tidal generator's turbine blades also turn slowly, which helps
marine life avoid getting caught in the system [15].
Fig.13: Tidal turbine.
13
6. Tidal energy to electric energy conversion:
The technology that is used to produce electricity using the difference between the
low and high tides is very similar to the one use on the generation of electricity on the
traditional hydroelectric power plants. The use of the tidal energy requires a dam or
barrage across a shallow area preferably an estuary, bay or gulf of high tidal range
where the difference on the low and high tide have to be at least 5 meters [8]. The tide
basins are filled and empty every day with the flood tides when water level falls. On
the barrage there are low-head turbines and sluice gates that allow the water to flow
from one side of the barrage to inside the tidal basin. This difference on elevation of
the water level creates a hydrostatic head that generates electricity. There are different
modes to generate electricity using the barrage systems:-
6.1. Ebb generation: Incoming water (flood tide) is allowed to flow freely to fill
the basin until high tide, then the sluices are close and water are retained on one side
of the barrage. When level of the water outside of the barrage decreased (ebb tide)
sufficiently to create a hydrostatic head between the open waters and tide basin, the
sluices are open and water flows through the turbines and generate electricity [16].
6.2. Flood generation: During the flood tide the sluices gates and low-head
turbines are kept closed to allow the water level outside of the barrage to increase.
Once a hydrostatic head is created the sluices gates are opened and the water flows
14
through the turbines into the basin. This mode is less efficient than the ebb generation
[8,17].
6.3. Two ways generation: This mode permits to generate electricity using the
ebb generation and the flood tide. The main problem with this type mode is that the
turbines must work both ways, when water enters or exits the basin. This requires
move expensive turbines and at this time computer simulations do not indicate that
this mode increases significantly the energy production [17].
6.4. Pumping: On the ebb generation the hydrostatic head can be increases
reversing the power and turning the turbine-generation into a pump motor. During the
generation the energy that was use is returned [17].
Fig.14: Power output of two way single basin tidal power station with pumping [12].
6.5. Double basin: All of the modes discuss above use one tide basin. Using tow
basins, the turbines are placed between the basins. The main basin will going to use
the ebb generation mode to operate and pump water with part of the energy that is
generated to and from the second basin to generated electricity continuously. This has
the disadvantage that is very expensive [17].
Fig.15: Schematic diagram of two basin tidal power station [12].
15
Fig.16: A diagram showing transformation of tidal energy to electric energy [13].
7. Energy of Tides:
The energy of the tide wave contains two components namely, potential and kinetic.
The potential energy is the work done in lifting the mass of water above the ocean
surface. This energy can be calculated as:
𝐸 = 𝑔𝜌𝐴 𝑧𝑑𝑧 = 0.5𝑔𝜌𝐴ℎ2
Where E is the energy, g is acceleration of gravity, ρ is the sea water density, which
it`s mass per unit volume, A is the sea area under consideration, z is a vertical
coordinate of the ocean surface and h is the tide amplitude. Taking an average
ρg = 10.15 KN 𝑚−3
for sea water, one can obtain for a tide cycle per square meter
of ocean surface:
𝐸 = 1.4ℎ2
, 𝑤𝑎𝑡𝑡 − ℎ𝑜𝑢𝑟 = 5.04ℎ2
, 𝑘𝑖𝑙𝑜𝑗𝑜𝑢𝑙𝑒
The kinetic energy T of the water mass m is its capacity to do work by virtue of it`s
velocity V. It is defined by 𝑇 = 0.5 𝑚 𝑉2
. The total tide energy equals the sum of
it`s potential and kinetic energy components.
Knowledge of the potential energy of the tide is important for designing conventional
tidal power plants using water dams for creating artificial upstream water heads. Such
16
power plants exploit the potential energy of vertical rise and fall of the water. In
contrast, the kinetic energy of the tide has to be known in order to design floating or
other types of tidal power plants which harness energy from tidal currents or
horizontal water Sows induced by tides. They do not involve installation of water
dams [18].
*Example calculation of tidal power generation:
Assumptions:
Let as assume that the tidal range of tide at a particular place is 32 feet =10m
(approx.).
The surface of the tidal energy harnessing plant is 9 2
(3 3 ) =3000
3000 = 10 2
.
Density of sea water = 1025.18kg/ 3
.
Mass of the sea water = .
=
= 10 2
10 1025.1 3
= 2 10 .
Potential energy content of the water in the basin at high tide =
1
2
.
P.E. =
1
2
10 2
1025.1 3 . 1
10 2
=4.5 1012
.
Now we have 2 high tides and 2 low tides every day. At low tide the potential energy
is zero.
Therefore the total energy potential per day = ℎ ℎ 2.
= 4.5 1012
2
= 1012
Thus the mean power generation potential=energy generation potential / time in 1 day
Power = 1012
6400
=104MW.
Assuming the power conversion efficiency to be 30% : The daily-average power
generated = 104 30 = 31 . .
Because the available power varies with the square of the tidal range, a barrage is
placed in a location with a very high-amplitude tides. Suitable locations are found in
17
Russia, U.S.A, Canada, Australia, Korea, and the U.K. Amplitudes of up to 17 m
(56ft) occur for example in The Bay of Fundy, where tidal resonance amplifies the
tidal range [19].
8. Tidal power around the world:
There are places that have large tidal ranges. Some of these places are The Bay of
Fundy Canada with a mean tidal range of 10m, Severn Estuary between England and
Wales with a mean range of 8m and the northern of France with a mean range of 7m.
The first large-scaled tide generation plant is located in Brittany on the La Rance
River on France. It was completed in 1966 at a cost of $100 million. The generation
plant has a capacity of 240 MW. The plant consists of 24 bulb-type turbine generators
of 5.35m (17.55ft.) diameter with 4 mobile pales and a rated capacity of 10 MW. The
barrage has a length of 910m (2986ft.) and serves as a four-lane highway that
connects Saint Malo and Dinard. The bulb turbines were design to operate on ebb or
flood generation mode and pump water either into or out of the basin when there are
slack tides periods. These turbines have the disadvantage that the water flows around
them and make the maintenance difficult and expensive. The plant is operated almost
of the time on the ebb generation mode because operate on the two-way generation
mode (ebb and flood tides) was prove not to be successful. Only when high spring
tides are present the plant operates on two-way generation mode. The plant average
generation was about 64 GW per year (0.012% France energy consumption). On 1996
the plant passes to a 10 years refurbishment plan for it is 24 bulb turbines [17].
Fig.17: Ebb generation with a bulb turbine.
18
9. Tidal giants - the world‟s five biggest tidal power plant:
The Swansea Bay tidal lagoon project in the UK and the MeyGen tidal array project
in Scotland stand out among the few large-scale tidal power projects currently under
development. Power-technology.com lists five of the world‟s biggest tidal power
plants, including those both operational and under construction.
9.1. Sihwa Lake Tidal Power Station, South Korea - 254MW:
With an output capacity of 254MW, the Sihwa Lake tidal power station located on
Lake Sihwa, approximately 4km from the city of Siheung in Gyeonggi Province of
South Korea, is the world's biggest tidal power plant.
The project, owned by Korea Water Resources Corporation, was opened in August
2011 and utilises a 12.5km long seawall constructed in 1994 for flood mitigation and
agricultural purposes. Power is generated on tidal inflows into the 30km2 basin with
the help of ten 25.4MW submerged bulb turbines. Eight culvert type sluice gates are
used for the water outflow from the barrage.
The $355.1m tidal power project was built between 2003 and 2010. Daewoo
Engineering & Construction was the engineering, procurement and construction
(EPC) contractor for the project. The annual generation capacity of the facility is
552.7GWh.
Fig.18: Sihwa lake tidal power station.
19
Fig.19: Project status by Google earth [20].
Fig.20: Operation of Sihwa Tidal power plant [20].
9.2. La Rance Tidal Power Plant, France - 240MW:
The 240MW La Rance tidal power plant on the estuary of the Rance River in
Brittany, France, has been operational since 1966 making it the world's oldest and
second biggest tidal power station. The renewable power plant, currently operated by
Électricité de France (EDF), has an annual generation capacity of 540GWh.
The La Rance tidal power facility, built between 1961 and 1966, involved the
construction of a 145.1m long barrage with six fixed wheel gates and a 163.6m-long
dyke. The basin area covered by the plant is 22km2. Power is produced through 24
reversible bulb turbines with a rated capacity of 10MW each.
20
The plant site features an average tidal range of 8.2m, the highest in France.
Electricity is fed into the 225kV national transmission network serving the needs of
approximately 130,000 households every year.
Fig.21: La Rance Tidal Power Plant, France.
9.3. Swansea Bay Tidal Lagoon, United Kingdom - 240MW
The 240MW Swansea Bay Tidal Lagoon project, to be built at Swansea Bay in the
UK, is the world's biggest tidal power project and will become the world's third
biggest tidal power project upon completion. The planning application for the £850m
($1.4bn) project was approved in March 2013.
The plant will be located at a site with average tidal range of 8.5m and will involve
the construction of a 9.5km-long sea wall or breakwater facility to create a lagoon
cordoning off 11.5km2 of sea. The plant will use reversible bulb turbines to generate
power as water passes in and out of the lagoon with the rise and fall of tides.
The ground breaking for the tidal power project is scheduled for 2015 while full
commissioning is expected in 2018. The tidal lagoon, with an estimated annual power
generation capacity 400GWh, will power over 120,000 homes for 120 years.
21
Fig.22: Swansea Bay Tidal Lagoon, United Kingdom.
9.4. MeyGen Tidal Energy Project, Scotland - 86MW:
MeyGen Tidal Energy Project located in the Inner Sound of the Pentland Firth off the
north coast of Caithness, Scotland, is currently the world's biggest underwater tidal
turbine power project under development.
The tidal array project received offshore planning consent for its 86MW first phase
development from the Scottish Government towards the end of 2013. The second
phase development of the project is expected to raise the total installed capacity to
398MW by 2020.
The MyGen project was initiated in 2006 by the Scottish company MeyGen, a joint
venture between the tidal technology company Atlantis Resources and Morgan
Stanley. Atlantis Resources acquired full ownership of the tidal array project in
December 2013. Construction is expected to start for a demonstration array involving
up to six AR1000 single-rotor tidal turbines in 2014 with final commissioning
expected in 2015. The first 1MW prototype of the 22.5m tall AR1000 tidal turbine
with 18m rotor diameter was deployed at the European Marine Energy Centre in2011.
22
Fig.23: MeyGen Tidal Energy Project, Scotland.
9.5. Annapolis Royal Generating Station, Canada - 20MW:
The Annapolis tidal power generating station located in the Annapolis Basin, a sub-
basin of the Bay of Fundy in Canada, has an installed capacity of 20MW making it
the world's third biggest operating tidal power plant. It generates 50GWh of electricity
annually to power over 4,000 homes.
The plant, operated by Nova Scotia Power, came online in 1984 after four years of
construction. The plant utilises a causeway built in the early 1960s, which was
originally designed to serve as a transportation link as well as a water control structure
to prevent flooding.
The power plant comprises of a single four blade turbine and sluice gates. The gates
are closed as the incoming tides create a head pond in the lower reaches of the
Annapolis River upstream of the causeway. The gates are opened and the water
rushing into the sea drives the turbine to generate power when a head of 1.6m or more
is created between the head pond and sea side with the falling of the tide [21].
23
Fig.24: Annapolis Royal Generating Station, Canada.
10. Environmental and Ecological Concerns of Tidal Energy:
Tidal power generation can offer significant advantages, including improved
transportation due to the development of traffic or rail bridges across estuaries and
reduced greenhouse gas emissions by utilizing tidal power in place of fossil fuels.
However there are also some significant environmental disadvantages which make
tidal power, particularly barrage systems less attractive than other forms of renewable
energy.
The construction of a tidal barrage in an estuary will change the tidal level in the
basin. This change is difficult to predict, and can result in a lowering or raising of the
tidal level. This change will also have a marked effect on the sedimentation and purity
of the water within the basin. In addition, navigation and recreation can be affected as
a result of a sea depth change due to increased sedimentation within the basin. A
raising of the tidal level could result in the flooding of the shoreline, which could have
an effect on the local marine food chain.
Potentially the largest disadvantage of tidal power is the effect a tidal station has on
the plants and animals which live within the estuary. As very few tidal barrages have
been built, very little is understood about the full impact of tidal power systems on the
local environment. What has been concluded is that the effect due to a tidal barrage is
highly dependent upon the local geography and marine ecosystem.
24

Fish may move through sluices safely, but when these are closed, fish will see
turbines and attempt to swim through them. Also, some fish will be unable to escape
the water speed near a turbine and will be sucked through [22].
*Fish Mortality:
There are two categories of threats to fish
*Direct: injury and mortality due to blade strike and water conditions (for example
water pressure) resulting in damage or disorientation.
*Indirect: loss and degradation of habitat which may be important for feeding and
spawning; and disruption to movement (such as completion of migration).
Mortality due to blade strike is the most studied source of fish mortality. Estimates
depend on the type and operation of a turbine, and species of fish. In order to reduce
levels of blade strike, the Oak Ridge National Laboratory (ORNL) produced a set of
criteria for the design of „fish-friendly‟ turbines. These criteria are based on an
extensive literature review of studies on single fish passage through turbines at hydro-
power schemes. In recent years, levels of survival greater than 90% have been
achieved. While high survivability is possible, no field trials of turbines in an
estuarine environment have been carried out. In addition, most studies of fish
mortality have been carried out on small-sized salmon, a notoriously robust species;
therefore reports of „negligible‟ mortality levels may not be applicable to the diversity
of fish, crustacean and invertebrate species common in estuaries such as adult salmon,
shad, flounder, brown shrimp. In addition, estimates of fish mortality are based on
fish making a single pass through a turbine: fish living in an estuary may make
multiple passes in a day, increasing their risk of mortality.
Less studied is mortality due to sub-lethal injuries, predation or indirect impacts.
During turbine passage, blade strike and hydraulic conditions can result in injuries
(for example scale loss, eye loss or abrasions) which may not cause immediate
mortality, but will reduce survival through disease or decreased fitness. Fish
commonly suffer disorientation during turbine passage which increases predation risk
by other fish, fish-eating birds and aquatic mammals; this has been observed at La
Rance. In a recent study, mortality because of predation of juvenile salmon was found
to account for between 46-70% of total mortality, indicating it is potentially a
considerable source of mortality. However, at present studies on mortality levels due
to predation pressure and sub-lethal injuries are limited [23].
*Very Low-Head Turbines:
Very Low-Head (VLH) turbines are a new technology that reportedly has a smaller
impact on fish than existing technologies. A recent trial on a VLH prototype achieved
100% survivability of both large and small eels. However, very few trials of VLH
turbines have been undertaken. In response to growing interest in VLH turbines, the
25
Canadian government published guidelines for the testing of these turbines. The
report comments that “mortality, although easy to define and measure, is simply one
way to evaluate the biological effectiveness of a turbine yet the majority of studies
focus only on mortality as an endpoint”. It suggests that a “suite of endpoints should
be examined which incorporate relevant metrics that have the potential to influence
long-term survival, health, condition and fitness” [23].
11. Advantages of Tidal energy:
There are a number of advantages to tidal energy. Because the force behind tidal
energy comes from the pull of the moon, it is an inexhaustible energy source. As long
as the moon continues to orbit the earth, there will be energy in the tides.
This relationship to the moon also makes tidal energy a predictable energy source.
Other forms of renewable energy, such as wind and solar energy, are dependent on
random weather patterns. But tidal energy is based on the rise and fall of tides, which
is more uniform and reliable.
It is a clean energy source because, unlike the burning of fossil fuels, it does not
release greenhouse gases or other pollutants into the air. It is also a cheap energy
source. After the initial investment is paid off, the cost of generating electricity is very
low. Tidal energy has a high energy density, meaning that the tides store a larger
amount of energy than most other forms of renewable energy, such as the wind [24].
12. Disadvantages of Tidal energy:
Despite this list of advantages, there are a number of disadvantages to tidal energy.
Tidal energy development is hampered by high upfront costs. For example, one study
noted that ocean power generation can cost more than $400 per MWH compared to
other renewable energy sources, such as wind, biomass, hydroelectric and geothermal
energy, that cost about $150 per MWH.
There are also limited suitable locations for tidal energy. A suitable location must
have sizable tides to justify the cost of constructing a power plant. Environmentalists
are concerned that tidal energy can be detrimental to marine life. Power plants can
disrupt the movements and migration of fish and other marine life in the oceans. Fish
can also be killed by the turbines.
Tidal energy can only be captured during the tides, so it is an intermittent energy
source. Because tides occur two times a day, in order for tidal energy to reach its full
potential, it must be paired with an efficient energy storage system [24].
26
13. Future outlook:
Although sustainable energy resources produce limited amounts of carbon dioxide
emissions, they are, by nature, reliant on the natural environment and therefore are
vulnerable to the effects of climate change. While sea level and wind pattern changes
are expected, tidal energy is less likely to be affected. This industry also has the
advantage of being predictable and quantifiable, both spatially and temporally.
It is also hoped that with future development of tidal current turbine technology, the
impact upon marine life can be reduced. In case of malfunction these type of facilities
do not impose any major catastrophic damage to the surroundings, compared to, say,
nuclear or hydroelectric dam failure [25].
Fig.25: Tidal Generation Emissions Savings.
27
14. Conclusion:
Tidal power has the potential to generate significant amounts of electricity at certain
sites around the world. Although our entire electricity needs could never be met by
tidal power alone, it can be a valuable source of renewable energy to an electrical
system. The negative environmental impacts of tidal barrages are probably much
smaller than those of other sources of electricity, but are not well understood at this
time. The technology required for tidal power is well developed, and the main barrier
to increased use of the tides is that of construction costs. The future costs of other
sources of electricity, and concern over their environmental impacts, will ultimately
determine whether humankind extensively harnesses the gravitational power of the
moon [13].
28
References:
1. Charlier. 2003. Sustainable Co-Generation from the tides: A Review.
Renewable and Sustainable Energy Reviews.
2. Clark, Nigel. 2006. Tidal barrages and birds. British Ornithologists'
Union, Ibis.
3. Aubrecht, Gordon. 2006. Energy: Physical, Environmental, and Social
Impact. Third Edition. Pearson Education Inc. San Francisco, CA.
4. Pontes and Falcao. 2001. Ocean Energies: Resources and Utilization.
5. Aquatic Renewable Energy Technologies (AquaRET). 2006.
6. Nicholls-Lee, R.F., S.R. Turnock. 2008. Tidal energy extraction:
renewable, sustainable and predictable.
7. Clark, P. , R. Klossner, L. Kologe. 2003. Tidal Energy.
8. R.H.Charlier, J.R. Justus."Ocean Engines: Environmental, Economic
and Technological Aspects of Alternatives Power Sources", Elsevier
1993.
9. U.S. Department of Commerce, "Tide and Current Glossary" National
Oceanic and Atmospheric Administration, January 2000.
10. P. Clark, R. Klossner, L. Kologe, "Tidal Energy", Final Project,
November 2003.
11. G. Hagerman, B. Polgye, "Methology for Estimating Tidal Current
Energy Resources and Power Production by Tidal In-stream Energy
Conversion (TISEC) Devices EPRI, September 2006.
12. K. Lyon, M. Rayner "Fact sheet 10: Tidal Energy", Australian
Institute of Energy Murdoch University, Australia, 2004.
13. Sh. Masuod, M. Amer, M. Samir, "Tidal Power Generation Systems",
Engineering Department, The American University in Cairo, Spring
2001.
http://en.wikipedia.org/wiki/Tidal_power.,Wikipedia14.
29
15. Marine Current Turbines Ltd,
http://www.ifremer.fr/dtmsi/colloques/seatech04/mp/proceedings_pdf/pre
marins/MCT.pdfsentations/4.%20courants_ .
16. World Energy Council, "Ocean Thermal Energy Conversion", Survey
of Energy Resources 2004, Ch.16 p.p. 419-432, Elservier.
http://www.uprm.edu/aret/docs/Ch_3_Ocean.pdf.17
18. A. M. Gorlov, "Tidal Energy", Northeastern University, Boston
Massachusetts, USA 2001.
Shaikh Md. R. Tousif, Shaiyek Md. B. Taslim19. , "Tidal Power: An
International Journal ofEffective Method of Generating Power",
Scientific & Engineering Research Volume 2, Issue 5, May-2011.
20. www.vatech-hydro.com.
technology.com-www.power ..12
http://www.hie.co.uk/aie/tidal_power.html..22
-Impact-http://www.parliament.uk/POST/postpn435_Environmental.32
Barragesreferences.pdf-Energy-of Tidal .
www.study.com..42
25. Nicholls-Lee, R.F., S.R. Turnock. 2008. Tidal energy extraction:
renewable, sustainable and predictable. Science Progress. 91:1 pg. 81-
http://www.swetswise.com.111. Retreieved at:

tidal energy

  • 1.
    1 University of Thi-Qar Collegeof Engineering Mechanical Engineering Department "Theoretical study about Tidal Energy" By Balqees Hmode Abdullah Supervised by Asst. Prof. Dr.Mushtaq I. Hasan
  • 2.
    2 Abstract This article isabout tidal power. It describes tidal power and the various methods of utilizing tidal power to generateelectricity. It briefly discusses each method and provides details of calculating tidal power generation and energy most effectively. The paper also focuses on the potential this method of generating electricity has and why this could be a common way of producing electricity in the near future.
  • 3.
    3 1. Overview: Tidal powerexploits energy drawn from the movement of ocean tides to produce electricity. There are two scenarios in which tides can be tapped for energy. The first is in changing sea levels. This phenomenon is responsible for the advancing and receding tides on shorelines. With the help of turbines, incoming tides can be manipulated to generate electricity. The second way to exploit tidal energy is by sinking turbines to the sea floor where fast-flowing currents turn generator blades much like wind does with a wind turbine. Tidal energy is considered renewable because the tides move on a predictable, daily schedule, depending only on the orbits of the Earth, Moon, and Sun, and are essentially inexhaustible [1]. Though tidal energy is carbon free, it is not environmentally benign. Concerns over the health of shoreline and aquatic ecosystems mar this otherwise clean source of energy. Older tidal barrage technology can devastate fish populations [2]. In the past, large-scale barrage systems dominated the tidal power scene. But because of increasingly evident unfavorable environmental and economic drawbacks with this technology, research into the field of tidal power shifted from barrage systems to tidal current turbines in the last few decades. This new technology leaves a smaller environmental footprint than tidal barrages, as turbines are placed in offshore currents avoiding the need to construct dams to capture the tides along ecologically fragile coastlines. Harnessing tidally- driven coastal currents cannot yet deliver the sheer amount of power that barrage style facilities can, like at the 240 MW barrage generating station at La Rance, France [3]. However, the technology is quickly evolving with numerous test plants popping up around the globe. Canada hosts two test sites, one tidal barrage and one tidal current power station. With one new and one old, both a history and a newfound interest in tidal power is apparent. The Annapolis Royal tidal barrage built in Nova Scotia's Bay of Fundy in 1984, with its world-famous tides, operates as the third largest tidal power plant in the world, with 20 MW [4]. The smaller Race Rocks facility in British Columbia, installed in 2006, uses tidal current technology to generate 65 kW of power [5]. Studies have estimated a potential 4,000 MW of untapped energy flowing along the coasts of BC [6]. Canada, and the shores of British Columbia, are home to some of the world's most attractive locations for tidal power development.
  • 4.
    4 2. Brief Historyof Tidal Power: The energy stored in tides been known to people for many centuries. The earliest records of tidal mills are dated back to the 8th Century CE [7]. The tidal mills were mainly used for grain grinding and were of similar design to the conventional water mills with the exception of the addition of a dam and reservoir. The industrial revolution increased demand for power but tidal energy never got off the ground, undercut by cheap fossil fuels and other developments which offered easier access to power generation. Existing tidal mills became as obsolescent as pre-industrial water- mills. The first large scale modern tidal electric plant started to operate in La Rance Estuary, St. Malo, France in the 1960s and has been operating ever since. In recent years the search for renewable, non-polluting energy sources and the increase in fossil fuel prices has encouraged renewed interest in tidal power. 3. Tides: The interaction of the sun-moon-earth system causes ones of the strangest phenomena: tides. Tides rise and fall is the product of the gravitational and centrifugal forces, of primarily the moon with the earth. The gravitational forces maintain the moon on it is positions with respect to the earth, forcing to pull the earth and the moon together, see figure 1. The centrifugal forces acts on the opposite direction pulling the moon away from the earth. These two forces acts together to maintain the equilibrium between these two masses. The influence of the sun can be included on the balance of the entire system. The distance plays an important role on the development of tides. Based on the newton law, the gravitational force is proportional to the square of the distance of two bodies, but tidal force is proportional to the cube of the distance. For this reason although the
  • 5.
    5 moon has amuch smaller mass than the sun it is much closer to the earth. The moon effect is 2 1 4 greater than that of the sun on the generation of tides [8]. The gravitational force of attraction of the moon causes that the oceans waters bulge on the side of the earth that faces the moon. The centrifugal force produce the same effect but in the opposite side of the earth. On these two sides it can be observe the maximum amplitudes of the tides (high tides) and on midways of it occur the minimum amplitudes of the tides (low tides). As the earth rotates these two bulges travel at the same rate as the earth`s rotation. The moon rotates around the earth with respect to the sun approximately 29.5 days (lunar month) in the same direction that the earth rotates every 24 hours. The rotation of the earth with respect to the moon is approximately 24.48 hours (24 hours and 50 minutes) and is called lunar day. This is the reason of why the tides advance approximately 50 minutes each day [9]. Fig.2: High and low tides. In the same manner that the ocean waters bulges towards the moon, the gravitational force of the sun causes that the ocean waters bulges too but in a lesser degree. Twice a month, when the earth, the moon and the sun are aligned (full and new moon) the tide generating forces of the sun and the moon are combined to produce tide ranges that are greater than average knowing as the spring tides [10]. At the half moon (first and third quarters) the sun and the moon are 90° with respect to the earth and the tide generating forces tend to produce tidal ranges that are less than the average knowing
  • 6.
    6 as the neaptides, see figure 3 [10]. Typically the spring tides range tend to be twice the neap tides range. The tidal movements can be reflect and restrict by the interruption of masses of land, the bottom friction can reduce it is velocity and the depth, size and shape of the ocean basins, bays and estuaries altered the movements of the tidal bulges and generate different types of tides [8]. There are three types of tides: diurnal, semidiurnal and mixed, see figure 4 [11].
  • 7.
    7 Diurnal tides (daily)present one single high and low water during a period of a lunar day of 24 hours and 50 minutes and occur in the Gulf of Mexico, southeast Asia and the coast of Korea, semidiurnal tides (twice a day) present two high an two low waters during a lunar day with periods of 12 hours and 50 minutes and is common along the Atlantic coast of North America and the mixed tides that presents two unequal high and two unequal lows waters and generally have a periods of 12 hours and 50 minutes. In a lunar month this type of tide that is common on the pacific Ocean coast of the United states can experience semidiurnal and diurnal tides characteristics. In 1964 Davis classified the tidal ranges as: micro-tidal with tidal range less than 2 meters, meso-tidal with tidal range between 2 and 4 meters and macro-tidal with tidal range of more than 4 meters [12]. 4. How Tidal Power Generation Systems Work? In very simple terms a barrage is built at the entrance of a gulf and the water levels vary on both sides of the small dam. Passages are made inside the dam and water flows through these passages and turbines rotate due to this flow of water under head of water. Thus, electricity is created using the turbines. A general diagram of the system is shown in Fig 5. What follows will be a description of a general tidal power station with its components. Also, many systems of power generation will be described. General scheme of the tidal power station.Fig.6: The components of a tidal power station are: 4.1. A barrage: a barrage is a small wall built at the entrance of a gulf in order to trap water behind it. It will either trap it by keeping it from going into the gulf when water levels at the sea are high or it will keep water from going into the sea when water level at the sea is low.
  • 8.
    8 4.2. Turbines: theyare the components responsible for converting potential energy into kinetic energy. They are located in the passageways that the water flows through when gates of barrage are opened. There are many types of turbines used in tidal power stations. A. Bulb turbines: as shown in Fig.7 these are difficult to maintain as water flows around them and the generator is in water. B. Rim turbines: as shown in Fig. 8 these are better maintained than the bulb turbines but are hard to regulate as generator is fixed in barrage. C. Tabular turbines: as shown in fig.9 these turbines are fixed to long shafts and thus solve both problems that bulb and rim turbines have as they are easier to maintain and control. Fig.7: A Bulb turbine. Fig.8: Rim turbines.
  • 9.
    9 Fig.9: Tabular turbines. 4.3.Sluices: sluice gates are the ones responsible for the flow of water through the barrage they could be seen in Fig.6. 4.4. Embankments: they are caissons made out of concrete to prevent water from flowing at certain parts of the dam and to help maintenance work and electrical wiring to be connected or used to move equipment or cars over it. These embankments are shown in Fig.10 [13]. Fig.10: Embankments.
  • 10.
    10 5. Tidal EnergyGenerators: There are currently three different ways to get tidal energy which are: 5.1. Tidal Fences: Tidal fences are composed of individual, vertical axis turbines which are mounted within the fence structure, known as a caisson. Kind of like giant turn styles which completely block a channel, forcing all of the water through them. Unlike barrage tidal power stations, tidal fences can also be used in unconfined basins, such as in the channel between the mainland and a nearby off shore island, or between two islands. Since they do not require flooding of the basin, tidal fences have much less impact on the environment, and are significantly cheaper to install. Unlike barrage generators, tidal fences have the advantage of being able to generate electricity once the initial modules are installed [14]. Fig.11: Tidal fences. 5.2. Tidal lagoons: Tidal lagoons are an adaptation of the barrage system. Similar to standard barrage models, tidal lagoons retain a head pond and generate power via conventional hydro- turbines. The difference is that the conventional barrage designs exploit the natural coast line to
  • 11.
    11 minimize barrage length.However, this entails blocking the estuary regardless of how deep it is. This raise the costs considerably. However, a lagoon, for a low cost can pretty much be built anywhere that there is a high tidal range. The lagoon has relatively little visual impact, as it is below the high water tide mark and appears like a normal sea wall at low tide. The lagoon can be built using loose aggregates found in quarries or demolished structures. This rubble would be „dumped‟ until an impound wall was complete. As any aggregate can be used, it is possible to restrict construction costs by implementing the cheapest materials available. This construction technique also has the added benefit of creating an artificial reef. As well, a calm water lake would be created in the middle where smaller fish and birds could flourish. Migrating fish can swim around unimpeded and without the danger of sluices or negotiating turbines [14]. Fig.12: Tidal lagoons. 5.3. Tidal Turbines For most tidal energy generators, turbines are placed in tidal streams. A tidal stream is a fast-flowing body of water created by tides. A turbine is a machine that takes energy from a flow of fluid. That fluid can be air (wind) or liquid (water). Because water is much more dense than air, tidal energy is more powerful than wind energy. Unlike wind, tides are predictable and stable. Where tidal generators are used, they produce a steady, reliable stream of electricity. Tidal turbines utilize tidal currents that are moving with velocities of between 2 and 3 m/s (4 to 6 knots) to generate between 4 and 13 kW/m2. Fast moving current (>3 m/s) can cause undue stress on the blades in a similar way that very strong gale force winds
  • 12.
    12 can damage traditionalwind turbine generators, whilst lower velocities are uneconomic. Placing turbines in tidal streams is complex, because the machines are large and disrupt the tide they are trying to harness. The environmental impact could be severe, depending on the size of the turbine and the site of the tidal stream. Turbines are most effective in shallow water. This produces more energy and allows ships to navigate around the turbines. A tidal generator's turbine blades also turn slowly, which helps marine life avoid getting caught in the system [15]. Fig.13: Tidal turbine.
  • 13.
    13 6. Tidal energyto electric energy conversion: The technology that is used to produce electricity using the difference between the low and high tides is very similar to the one use on the generation of electricity on the traditional hydroelectric power plants. The use of the tidal energy requires a dam or barrage across a shallow area preferably an estuary, bay or gulf of high tidal range where the difference on the low and high tide have to be at least 5 meters [8]. The tide basins are filled and empty every day with the flood tides when water level falls. On the barrage there are low-head turbines and sluice gates that allow the water to flow from one side of the barrage to inside the tidal basin. This difference on elevation of the water level creates a hydrostatic head that generates electricity. There are different modes to generate electricity using the barrage systems:- 6.1. Ebb generation: Incoming water (flood tide) is allowed to flow freely to fill the basin until high tide, then the sluices are close and water are retained on one side of the barrage. When level of the water outside of the barrage decreased (ebb tide) sufficiently to create a hydrostatic head between the open waters and tide basin, the sluices are open and water flows through the turbines and generate electricity [16]. 6.2. Flood generation: During the flood tide the sluices gates and low-head turbines are kept closed to allow the water level outside of the barrage to increase. Once a hydrostatic head is created the sluices gates are opened and the water flows
  • 14.
    14 through the turbinesinto the basin. This mode is less efficient than the ebb generation [8,17]. 6.3. Two ways generation: This mode permits to generate electricity using the ebb generation and the flood tide. The main problem with this type mode is that the turbines must work both ways, when water enters or exits the basin. This requires move expensive turbines and at this time computer simulations do not indicate that this mode increases significantly the energy production [17]. 6.4. Pumping: On the ebb generation the hydrostatic head can be increases reversing the power and turning the turbine-generation into a pump motor. During the generation the energy that was use is returned [17]. Fig.14: Power output of two way single basin tidal power station with pumping [12]. 6.5. Double basin: All of the modes discuss above use one tide basin. Using tow basins, the turbines are placed between the basins. The main basin will going to use the ebb generation mode to operate and pump water with part of the energy that is generated to and from the second basin to generated electricity continuously. This has the disadvantage that is very expensive [17]. Fig.15: Schematic diagram of two basin tidal power station [12].
  • 15.
    15 Fig.16: A diagramshowing transformation of tidal energy to electric energy [13]. 7. Energy of Tides: The energy of the tide wave contains two components namely, potential and kinetic. The potential energy is the work done in lifting the mass of water above the ocean surface. This energy can be calculated as: 𝐸 = 𝑔𝜌𝐴 𝑧𝑑𝑧 = 0.5𝑔𝜌𝐴ℎ2 Where E is the energy, g is acceleration of gravity, ρ is the sea water density, which it`s mass per unit volume, A is the sea area under consideration, z is a vertical coordinate of the ocean surface and h is the tide amplitude. Taking an average ρg = 10.15 KN 𝑚−3 for sea water, one can obtain for a tide cycle per square meter of ocean surface: 𝐸 = 1.4ℎ2 , 𝑤𝑎𝑡𝑡 − ℎ𝑜𝑢𝑟 = 5.04ℎ2 , 𝑘𝑖𝑙𝑜𝑗𝑜𝑢𝑙𝑒 The kinetic energy T of the water mass m is its capacity to do work by virtue of it`s velocity V. It is defined by 𝑇 = 0.5 𝑚 𝑉2 . The total tide energy equals the sum of it`s potential and kinetic energy components. Knowledge of the potential energy of the tide is important for designing conventional tidal power plants using water dams for creating artificial upstream water heads. Such
  • 16.
    16 power plants exploitthe potential energy of vertical rise and fall of the water. In contrast, the kinetic energy of the tide has to be known in order to design floating or other types of tidal power plants which harness energy from tidal currents or horizontal water Sows induced by tides. They do not involve installation of water dams [18]. *Example calculation of tidal power generation: Assumptions: Let as assume that the tidal range of tide at a particular place is 32 feet =10m (approx.). The surface of the tidal energy harnessing plant is 9 2 (3 3 ) =3000 3000 = 10 2 . Density of sea water = 1025.18kg/ 3 . Mass of the sea water = . = = 10 2 10 1025.1 3 = 2 10 . Potential energy content of the water in the basin at high tide = 1 2 . P.E. = 1 2 10 2 1025.1 3 . 1 10 2 =4.5 1012 . Now we have 2 high tides and 2 low tides every day. At low tide the potential energy is zero. Therefore the total energy potential per day = ℎ ℎ 2. = 4.5 1012 2 = 1012 Thus the mean power generation potential=energy generation potential / time in 1 day Power = 1012 6400 =104MW. Assuming the power conversion efficiency to be 30% : The daily-average power generated = 104 30 = 31 . . Because the available power varies with the square of the tidal range, a barrage is placed in a location with a very high-amplitude tides. Suitable locations are found in
  • 17.
    17 Russia, U.S.A, Canada,Australia, Korea, and the U.K. Amplitudes of up to 17 m (56ft) occur for example in The Bay of Fundy, where tidal resonance amplifies the tidal range [19]. 8. Tidal power around the world: There are places that have large tidal ranges. Some of these places are The Bay of Fundy Canada with a mean tidal range of 10m, Severn Estuary between England and Wales with a mean range of 8m and the northern of France with a mean range of 7m. The first large-scaled tide generation plant is located in Brittany on the La Rance River on France. It was completed in 1966 at a cost of $100 million. The generation plant has a capacity of 240 MW. The plant consists of 24 bulb-type turbine generators of 5.35m (17.55ft.) diameter with 4 mobile pales and a rated capacity of 10 MW. The barrage has a length of 910m (2986ft.) and serves as a four-lane highway that connects Saint Malo and Dinard. The bulb turbines were design to operate on ebb or flood generation mode and pump water either into or out of the basin when there are slack tides periods. These turbines have the disadvantage that the water flows around them and make the maintenance difficult and expensive. The plant is operated almost of the time on the ebb generation mode because operate on the two-way generation mode (ebb and flood tides) was prove not to be successful. Only when high spring tides are present the plant operates on two-way generation mode. The plant average generation was about 64 GW per year (0.012% France energy consumption). On 1996 the plant passes to a 10 years refurbishment plan for it is 24 bulb turbines [17]. Fig.17: Ebb generation with a bulb turbine.
  • 18.
    18 9. Tidal giants- the world‟s five biggest tidal power plant: The Swansea Bay tidal lagoon project in the UK and the MeyGen tidal array project in Scotland stand out among the few large-scale tidal power projects currently under development. Power-technology.com lists five of the world‟s biggest tidal power plants, including those both operational and under construction. 9.1. Sihwa Lake Tidal Power Station, South Korea - 254MW: With an output capacity of 254MW, the Sihwa Lake tidal power station located on Lake Sihwa, approximately 4km from the city of Siheung in Gyeonggi Province of South Korea, is the world's biggest tidal power plant. The project, owned by Korea Water Resources Corporation, was opened in August 2011 and utilises a 12.5km long seawall constructed in 1994 for flood mitigation and agricultural purposes. Power is generated on tidal inflows into the 30km2 basin with the help of ten 25.4MW submerged bulb turbines. Eight culvert type sluice gates are used for the water outflow from the barrage. The $355.1m tidal power project was built between 2003 and 2010. Daewoo Engineering & Construction was the engineering, procurement and construction (EPC) contractor for the project. The annual generation capacity of the facility is 552.7GWh. Fig.18: Sihwa lake tidal power station.
  • 19.
    19 Fig.19: Project statusby Google earth [20]. Fig.20: Operation of Sihwa Tidal power plant [20]. 9.2. La Rance Tidal Power Plant, France - 240MW: The 240MW La Rance tidal power plant on the estuary of the Rance River in Brittany, France, has been operational since 1966 making it the world's oldest and second biggest tidal power station. The renewable power plant, currently operated by Électricité de France (EDF), has an annual generation capacity of 540GWh. The La Rance tidal power facility, built between 1961 and 1966, involved the construction of a 145.1m long barrage with six fixed wheel gates and a 163.6m-long dyke. The basin area covered by the plant is 22km2. Power is produced through 24 reversible bulb turbines with a rated capacity of 10MW each.
  • 20.
    20 The plant sitefeatures an average tidal range of 8.2m, the highest in France. Electricity is fed into the 225kV national transmission network serving the needs of approximately 130,000 households every year. Fig.21: La Rance Tidal Power Plant, France. 9.3. Swansea Bay Tidal Lagoon, United Kingdom - 240MW The 240MW Swansea Bay Tidal Lagoon project, to be built at Swansea Bay in the UK, is the world's biggest tidal power project and will become the world's third biggest tidal power project upon completion. The planning application for the £850m ($1.4bn) project was approved in March 2013. The plant will be located at a site with average tidal range of 8.5m and will involve the construction of a 9.5km-long sea wall or breakwater facility to create a lagoon cordoning off 11.5km2 of sea. The plant will use reversible bulb turbines to generate power as water passes in and out of the lagoon with the rise and fall of tides. The ground breaking for the tidal power project is scheduled for 2015 while full commissioning is expected in 2018. The tidal lagoon, with an estimated annual power generation capacity 400GWh, will power over 120,000 homes for 120 years.
  • 21.
    21 Fig.22: Swansea BayTidal Lagoon, United Kingdom. 9.4. MeyGen Tidal Energy Project, Scotland - 86MW: MeyGen Tidal Energy Project located in the Inner Sound of the Pentland Firth off the north coast of Caithness, Scotland, is currently the world's biggest underwater tidal turbine power project under development. The tidal array project received offshore planning consent for its 86MW first phase development from the Scottish Government towards the end of 2013. The second phase development of the project is expected to raise the total installed capacity to 398MW by 2020. The MyGen project was initiated in 2006 by the Scottish company MeyGen, a joint venture between the tidal technology company Atlantis Resources and Morgan Stanley. Atlantis Resources acquired full ownership of the tidal array project in December 2013. Construction is expected to start for a demonstration array involving up to six AR1000 single-rotor tidal turbines in 2014 with final commissioning expected in 2015. The first 1MW prototype of the 22.5m tall AR1000 tidal turbine with 18m rotor diameter was deployed at the European Marine Energy Centre in2011.
  • 22.
    22 Fig.23: MeyGen TidalEnergy Project, Scotland. 9.5. Annapolis Royal Generating Station, Canada - 20MW: The Annapolis tidal power generating station located in the Annapolis Basin, a sub- basin of the Bay of Fundy in Canada, has an installed capacity of 20MW making it the world's third biggest operating tidal power plant. It generates 50GWh of electricity annually to power over 4,000 homes. The plant, operated by Nova Scotia Power, came online in 1984 after four years of construction. The plant utilises a causeway built in the early 1960s, which was originally designed to serve as a transportation link as well as a water control structure to prevent flooding. The power plant comprises of a single four blade turbine and sluice gates. The gates are closed as the incoming tides create a head pond in the lower reaches of the Annapolis River upstream of the causeway. The gates are opened and the water rushing into the sea drives the turbine to generate power when a head of 1.6m or more is created between the head pond and sea side with the falling of the tide [21].
  • 23.
    23 Fig.24: Annapolis RoyalGenerating Station, Canada. 10. Environmental and Ecological Concerns of Tidal Energy: Tidal power generation can offer significant advantages, including improved transportation due to the development of traffic or rail bridges across estuaries and reduced greenhouse gas emissions by utilizing tidal power in place of fossil fuels. However there are also some significant environmental disadvantages which make tidal power, particularly barrage systems less attractive than other forms of renewable energy. The construction of a tidal barrage in an estuary will change the tidal level in the basin. This change is difficult to predict, and can result in a lowering or raising of the tidal level. This change will also have a marked effect on the sedimentation and purity of the water within the basin. In addition, navigation and recreation can be affected as a result of a sea depth change due to increased sedimentation within the basin. A raising of the tidal level could result in the flooding of the shoreline, which could have an effect on the local marine food chain. Potentially the largest disadvantage of tidal power is the effect a tidal station has on the plants and animals which live within the estuary. As very few tidal barrages have been built, very little is understood about the full impact of tidal power systems on the local environment. What has been concluded is that the effect due to a tidal barrage is highly dependent upon the local geography and marine ecosystem.
  • 24.
    24 Fish may movethrough sluices safely, but when these are closed, fish will see turbines and attempt to swim through them. Also, some fish will be unable to escape the water speed near a turbine and will be sucked through [22]. *Fish Mortality: There are two categories of threats to fish *Direct: injury and mortality due to blade strike and water conditions (for example water pressure) resulting in damage or disorientation. *Indirect: loss and degradation of habitat which may be important for feeding and spawning; and disruption to movement (such as completion of migration). Mortality due to blade strike is the most studied source of fish mortality. Estimates depend on the type and operation of a turbine, and species of fish. In order to reduce levels of blade strike, the Oak Ridge National Laboratory (ORNL) produced a set of criteria for the design of „fish-friendly‟ turbines. These criteria are based on an extensive literature review of studies on single fish passage through turbines at hydro- power schemes. In recent years, levels of survival greater than 90% have been achieved. While high survivability is possible, no field trials of turbines in an estuarine environment have been carried out. In addition, most studies of fish mortality have been carried out on small-sized salmon, a notoriously robust species; therefore reports of „negligible‟ mortality levels may not be applicable to the diversity of fish, crustacean and invertebrate species common in estuaries such as adult salmon, shad, flounder, brown shrimp. In addition, estimates of fish mortality are based on fish making a single pass through a turbine: fish living in an estuary may make multiple passes in a day, increasing their risk of mortality. Less studied is mortality due to sub-lethal injuries, predation or indirect impacts. During turbine passage, blade strike and hydraulic conditions can result in injuries (for example scale loss, eye loss or abrasions) which may not cause immediate mortality, but will reduce survival through disease or decreased fitness. Fish commonly suffer disorientation during turbine passage which increases predation risk by other fish, fish-eating birds and aquatic mammals; this has been observed at La Rance. In a recent study, mortality because of predation of juvenile salmon was found to account for between 46-70% of total mortality, indicating it is potentially a considerable source of mortality. However, at present studies on mortality levels due to predation pressure and sub-lethal injuries are limited [23]. *Very Low-Head Turbines: Very Low-Head (VLH) turbines are a new technology that reportedly has a smaller impact on fish than existing technologies. A recent trial on a VLH prototype achieved 100% survivability of both large and small eels. However, very few trials of VLH turbines have been undertaken. In response to growing interest in VLH turbines, the
  • 25.
    25 Canadian government publishedguidelines for the testing of these turbines. The report comments that “mortality, although easy to define and measure, is simply one way to evaluate the biological effectiveness of a turbine yet the majority of studies focus only on mortality as an endpoint”. It suggests that a “suite of endpoints should be examined which incorporate relevant metrics that have the potential to influence long-term survival, health, condition and fitness” [23]. 11. Advantages of Tidal energy: There are a number of advantages to tidal energy. Because the force behind tidal energy comes from the pull of the moon, it is an inexhaustible energy source. As long as the moon continues to orbit the earth, there will be energy in the tides. This relationship to the moon also makes tidal energy a predictable energy source. Other forms of renewable energy, such as wind and solar energy, are dependent on random weather patterns. But tidal energy is based on the rise and fall of tides, which is more uniform and reliable. It is a clean energy source because, unlike the burning of fossil fuels, it does not release greenhouse gases or other pollutants into the air. It is also a cheap energy source. After the initial investment is paid off, the cost of generating electricity is very low. Tidal energy has a high energy density, meaning that the tides store a larger amount of energy than most other forms of renewable energy, such as the wind [24]. 12. Disadvantages of Tidal energy: Despite this list of advantages, there are a number of disadvantages to tidal energy. Tidal energy development is hampered by high upfront costs. For example, one study noted that ocean power generation can cost more than $400 per MWH compared to other renewable energy sources, such as wind, biomass, hydroelectric and geothermal energy, that cost about $150 per MWH. There are also limited suitable locations for tidal energy. A suitable location must have sizable tides to justify the cost of constructing a power plant. Environmentalists are concerned that tidal energy can be detrimental to marine life. Power plants can disrupt the movements and migration of fish and other marine life in the oceans. Fish can also be killed by the turbines. Tidal energy can only be captured during the tides, so it is an intermittent energy source. Because tides occur two times a day, in order for tidal energy to reach its full potential, it must be paired with an efficient energy storage system [24].
  • 26.
    26 13. Future outlook: Althoughsustainable energy resources produce limited amounts of carbon dioxide emissions, they are, by nature, reliant on the natural environment and therefore are vulnerable to the effects of climate change. While sea level and wind pattern changes are expected, tidal energy is less likely to be affected. This industry also has the advantage of being predictable and quantifiable, both spatially and temporally. It is also hoped that with future development of tidal current turbine technology, the impact upon marine life can be reduced. In case of malfunction these type of facilities do not impose any major catastrophic damage to the surroundings, compared to, say, nuclear or hydroelectric dam failure [25]. Fig.25: Tidal Generation Emissions Savings.
  • 27.
    27 14. Conclusion: Tidal powerhas the potential to generate significant amounts of electricity at certain sites around the world. Although our entire electricity needs could never be met by tidal power alone, it can be a valuable source of renewable energy to an electrical system. The negative environmental impacts of tidal barrages are probably much smaller than those of other sources of electricity, but are not well understood at this time. The technology required for tidal power is well developed, and the main barrier to increased use of the tides is that of construction costs. The future costs of other sources of electricity, and concern over their environmental impacts, will ultimately determine whether humankind extensively harnesses the gravitational power of the moon [13].
  • 28.
    28 References: 1. Charlier. 2003.Sustainable Co-Generation from the tides: A Review. Renewable and Sustainable Energy Reviews. 2. Clark, Nigel. 2006. Tidal barrages and birds. British Ornithologists' Union, Ibis. 3. Aubrecht, Gordon. 2006. Energy: Physical, Environmental, and Social Impact. Third Edition. Pearson Education Inc. San Francisco, CA. 4. Pontes and Falcao. 2001. Ocean Energies: Resources and Utilization. 5. Aquatic Renewable Energy Technologies (AquaRET). 2006. 6. Nicholls-Lee, R.F., S.R. Turnock. 2008. Tidal energy extraction: renewable, sustainable and predictable. 7. Clark, P. , R. Klossner, L. Kologe. 2003. Tidal Energy. 8. R.H.Charlier, J.R. Justus."Ocean Engines: Environmental, Economic and Technological Aspects of Alternatives Power Sources", Elsevier 1993. 9. U.S. Department of Commerce, "Tide and Current Glossary" National Oceanic and Atmospheric Administration, January 2000. 10. P. Clark, R. Klossner, L. Kologe, "Tidal Energy", Final Project, November 2003. 11. G. Hagerman, B. Polgye, "Methology for Estimating Tidal Current Energy Resources and Power Production by Tidal In-stream Energy Conversion (TISEC) Devices EPRI, September 2006. 12. K. Lyon, M. Rayner "Fact sheet 10: Tidal Energy", Australian Institute of Energy Murdoch University, Australia, 2004. 13. Sh. Masuod, M. Amer, M. Samir, "Tidal Power Generation Systems", Engineering Department, The American University in Cairo, Spring 2001. http://en.wikipedia.org/wiki/Tidal_power.,Wikipedia14.
  • 29.
    29 15. Marine CurrentTurbines Ltd, http://www.ifremer.fr/dtmsi/colloques/seatech04/mp/proceedings_pdf/pre marins/MCT.pdfsentations/4.%20courants_ . 16. World Energy Council, "Ocean Thermal Energy Conversion", Survey of Energy Resources 2004, Ch.16 p.p. 419-432, Elservier. http://www.uprm.edu/aret/docs/Ch_3_Ocean.pdf.17 18. A. M. Gorlov, "Tidal Energy", Northeastern University, Boston Massachusetts, USA 2001. Shaikh Md. R. Tousif, Shaiyek Md. B. Taslim19. , "Tidal Power: An International Journal ofEffective Method of Generating Power", Scientific & Engineering Research Volume 2, Issue 5, May-2011. 20. www.vatech-hydro.com. technology.com-www.power ..12 http://www.hie.co.uk/aie/tidal_power.html..22 -Impact-http://www.parliament.uk/POST/postpn435_Environmental.32 Barragesreferences.pdf-Energy-of Tidal . www.study.com..42 25. Nicholls-Lee, R.F., S.R. Turnock. 2008. Tidal energy extraction: renewable, sustainable and predictable. Science Progress. 91:1 pg. 81- http://www.swetswise.com.111. Retreieved at:
