Quantitative Project Risk Analysis
1
Intaver Institute Inc.
303, 6707, Elbow Drive S.W.,
Calgary AB Canada T2V 0E5
www.intaver.com

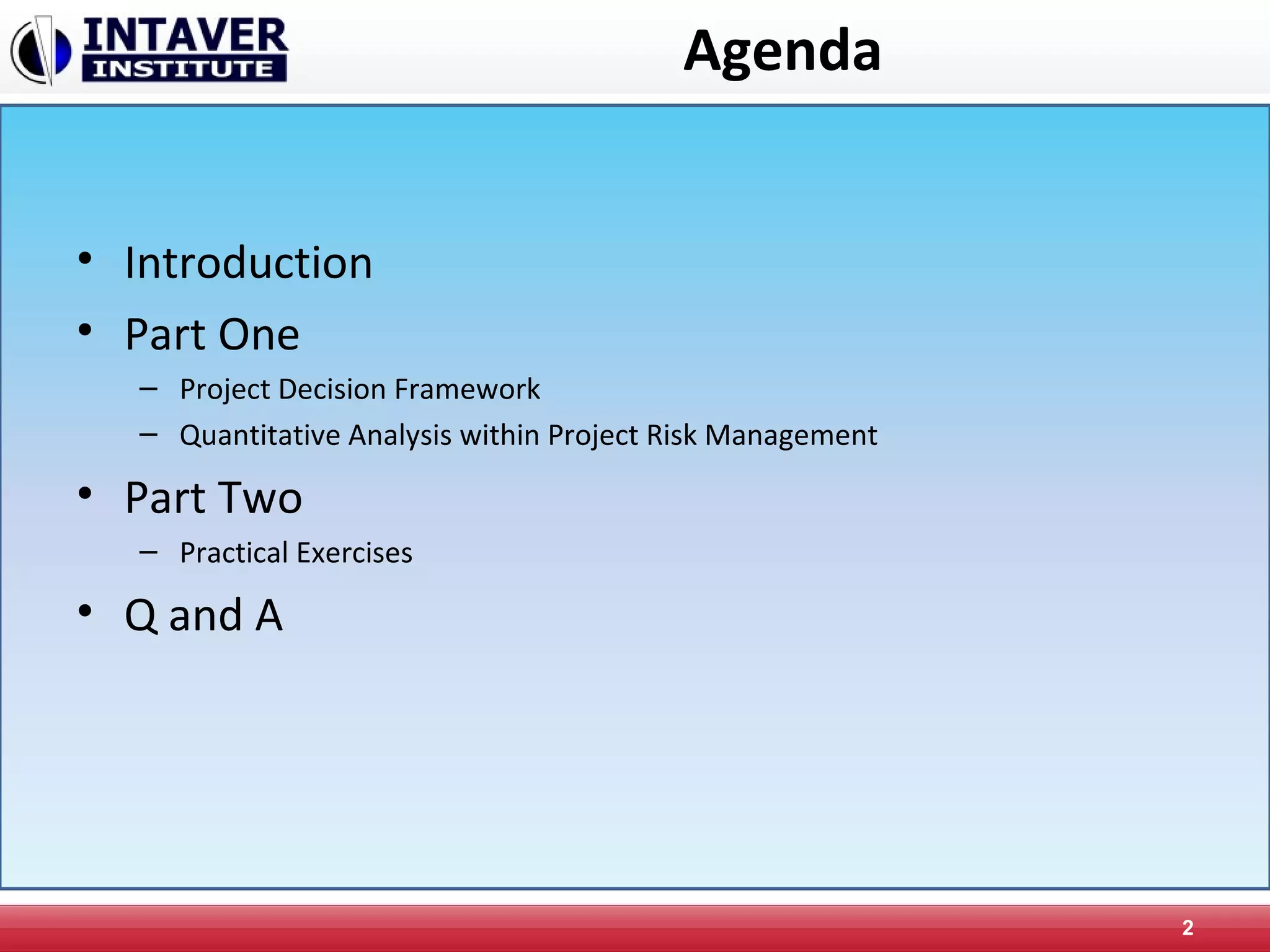

Agenda
• Introduction
• Part One
– Project Decision Framework
– Quantitative Analysis within Project Risk Management
• Part Two
– Practical Exercises
• Q and A
2

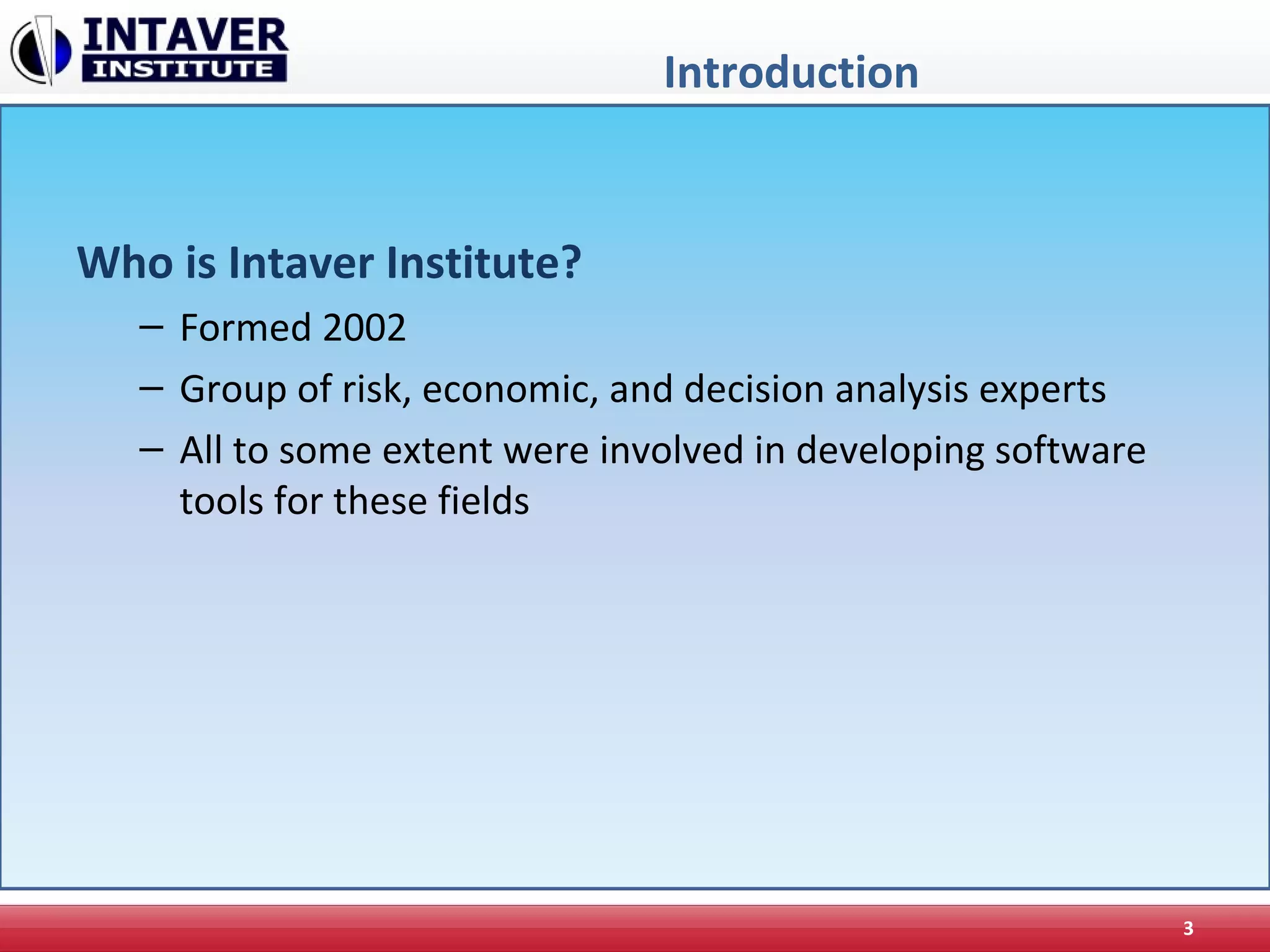

Introduction
Who is Intaver Institute?
– Formed 2002
– Group of risk, economic, and decision analysis experts
– All to some extent were involved in developing software
tools for these fields
3

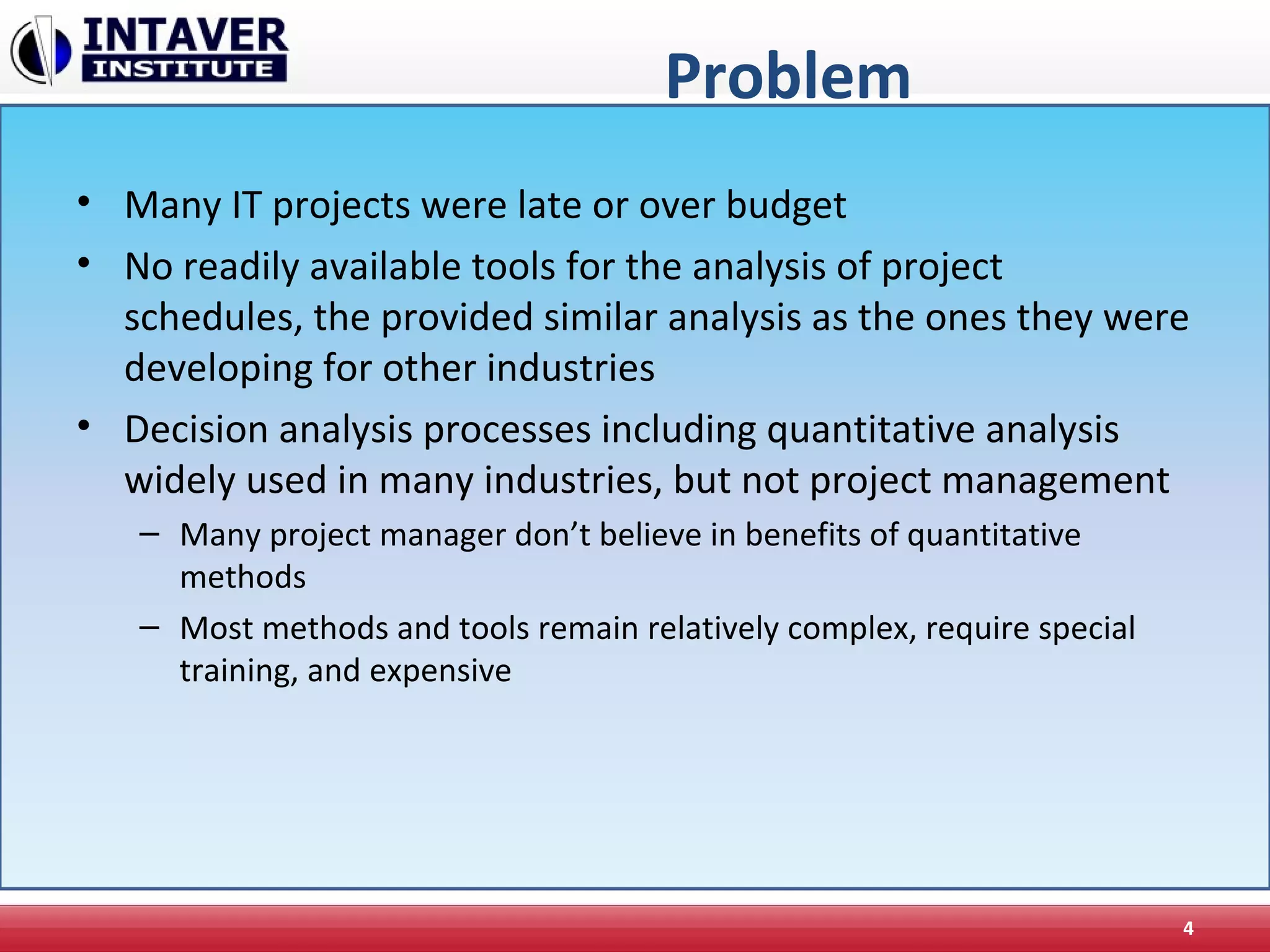

Problem
• Many IT projects were late or over budget
• No readily available tools for the analysis of project
schedules, the provided similar analysis as the ones they were
developing for other industries
• Decision analysis processes including quantitative analysis
widely used in many industries, but not project management
– Many project manager don’t believe in benefits of quantitative
methods
– Most methods and tools remain relatively complex, require special
training, and expensive
4

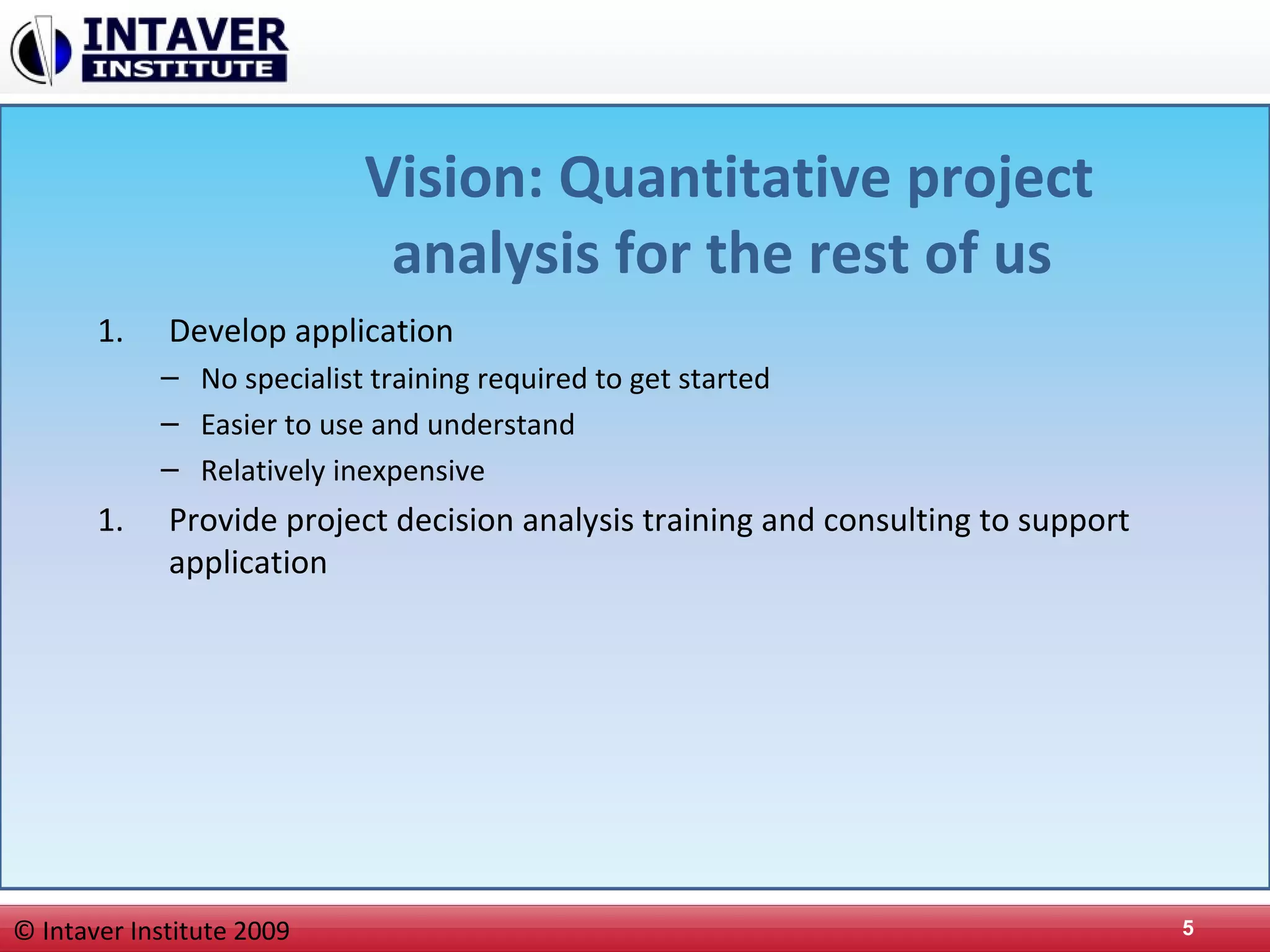

Vision: Quantitative project
analysis for the rest of us
1. Develop application
– No specialist training required to get started
– Easier to use and understand
– Relatively inexpensive
1. Provide project decision analysis training and consulting to support
application
5© Intaver Institute 2009
Part One: Project Decisions Framework and
Quantitative Analysis
• Project Decision Analysis
• Quantitative Project Risk Analysis and Management
6

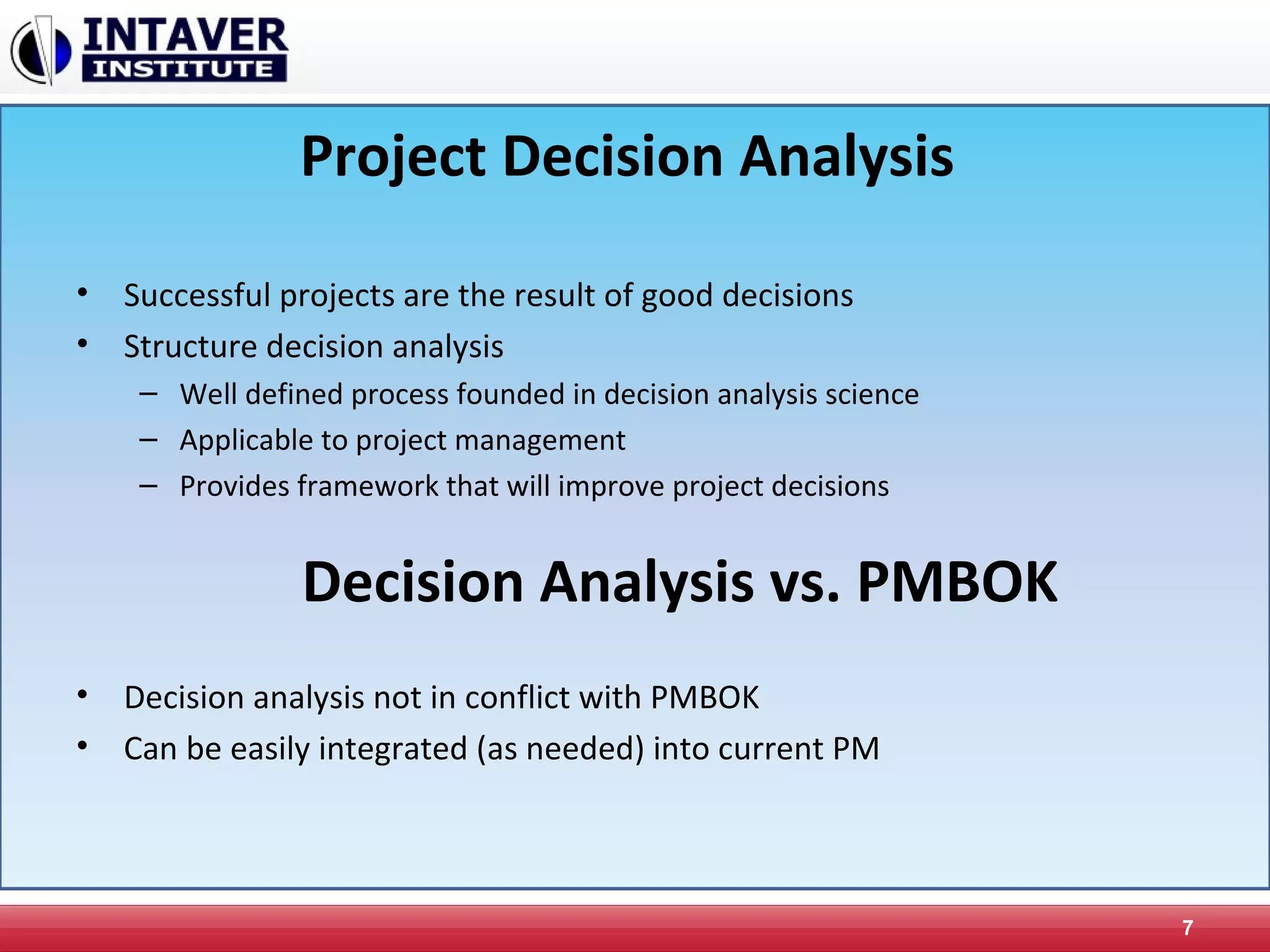

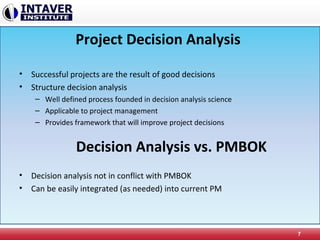

Project Decision Analysis
• Successful projects are the result of good decisions
• Structure decision analysis
– Well defined process founded in decision analysis science
– Applicable to project management
– Provides framework that will improve project decisions
7
Decision Analysis vs. PMBOK
• Decision analysis not in conflict with PMBOK
• Can be easily integrated (as needed) into current PM

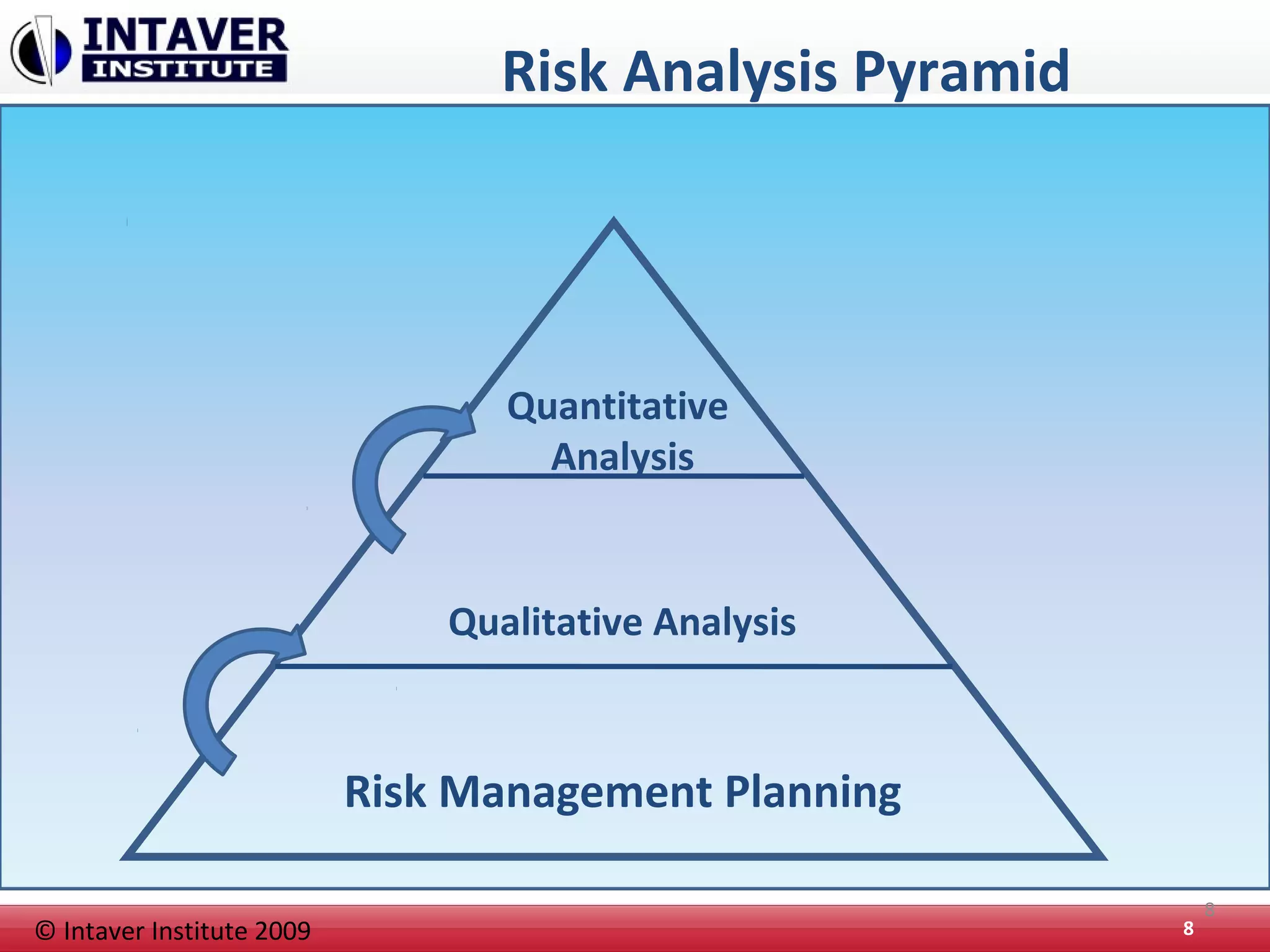

Risk Analysis Pyramid
8
Quantitative
Analysis
Qualitative Analysis
Risk Management Planning
© Intaver Institute 2009
8

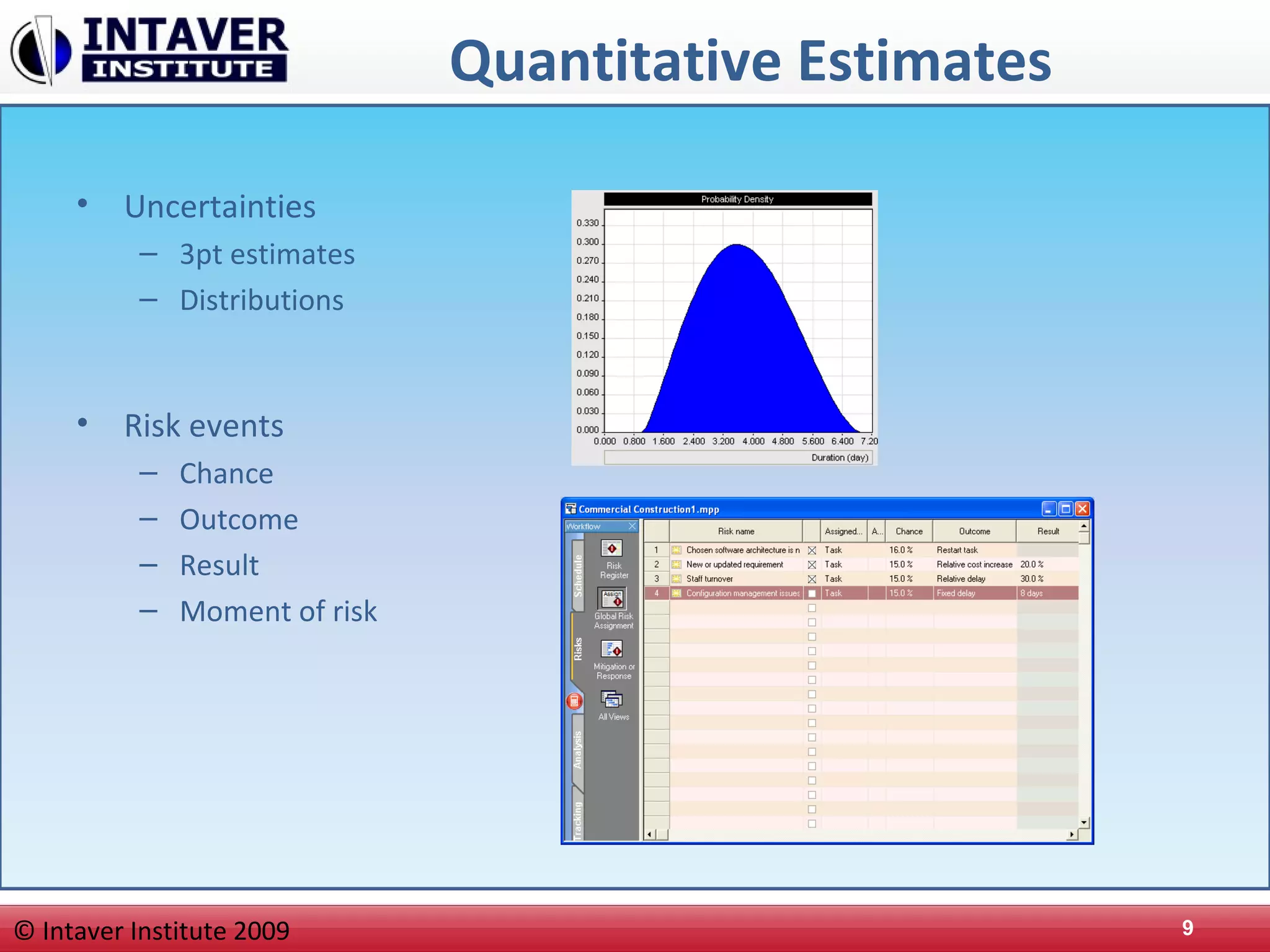

Quantitative Estimates
• Uncertainties
– 3pt estimates
– Distributions
• Risk events
– Chance
– Outcome
– Result
– Moment of risk
9© Intaver Institute 2009
Types of uncertainties
• Duration
• Cost
• Start and Finish Times
• Lags
• Rates and Resource Allocation
• Entered as 3 pt estimate
10© Intaver Institute 2009

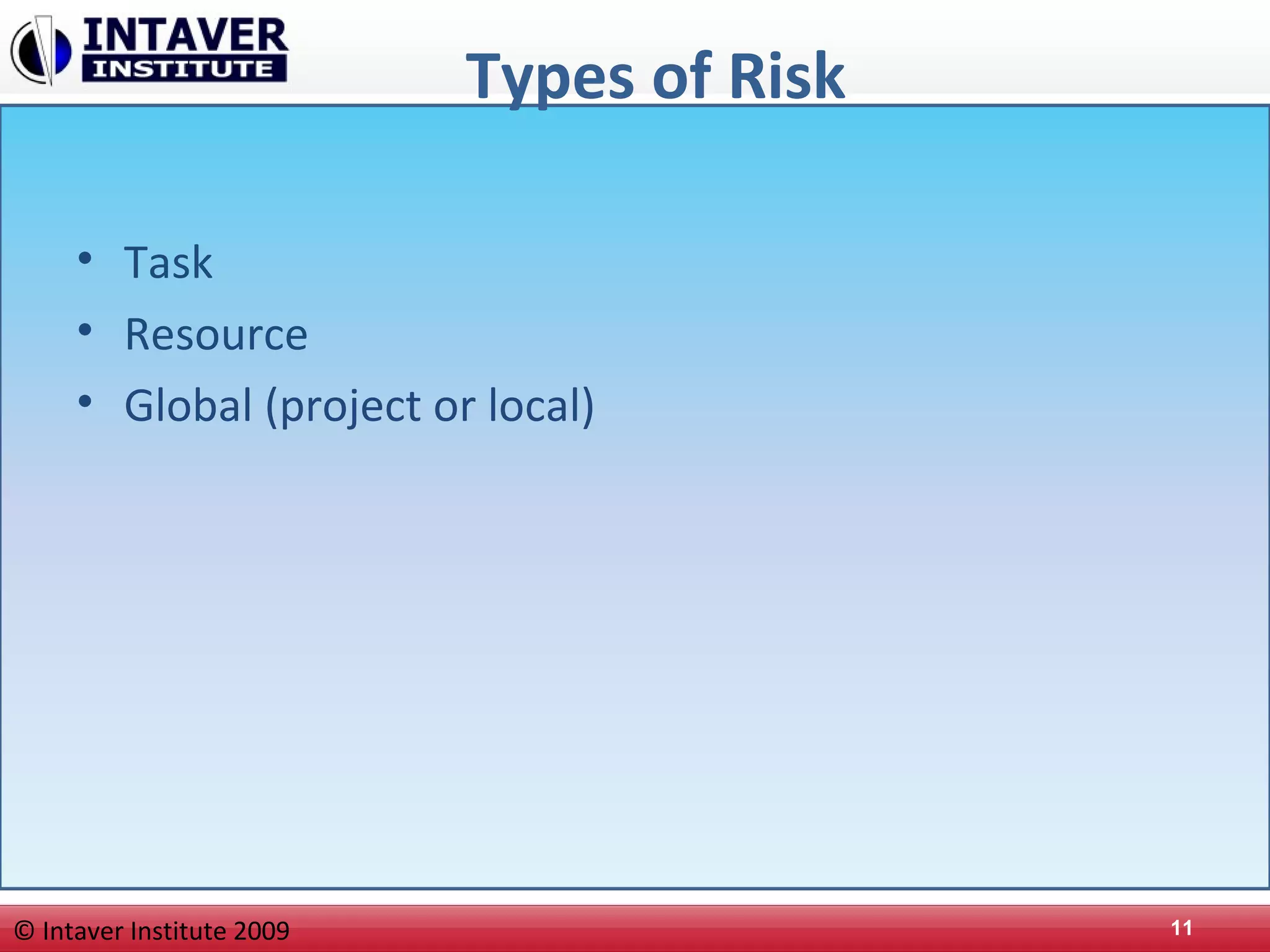

Types of Risk
• Task
• Resource
• Global (project or local)
11© Intaver Institute 2009

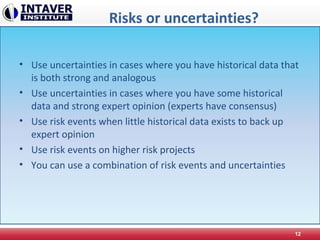

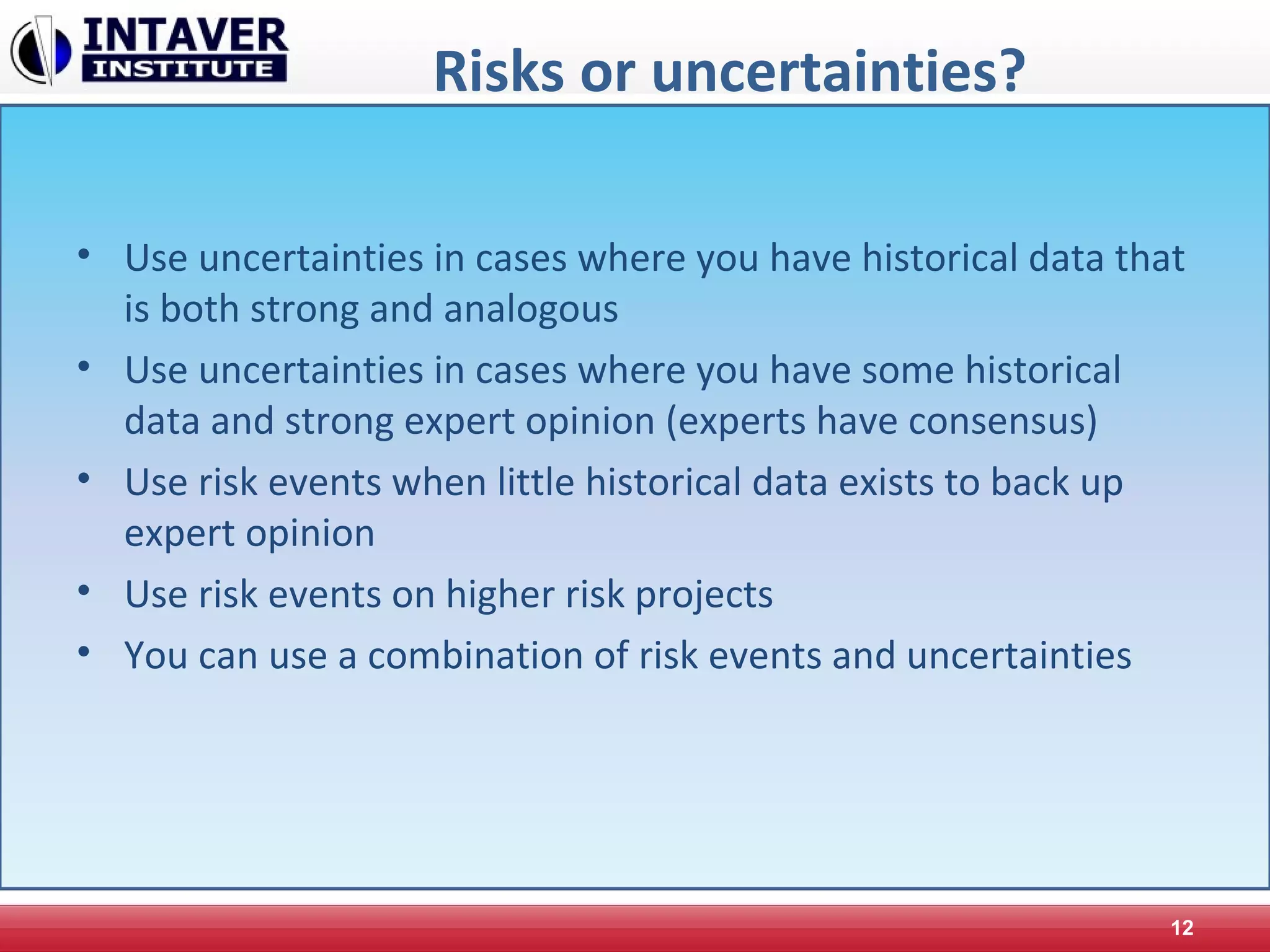

Risks or uncertainties?
• Use uncertainties in cases where you have historical data that
is both strong and analogous
• Use uncertainties in cases where you have some historical
data and strong expert opinion (experts have consensus)
• Use risk events when little historical data exists to back up
expert opinion
• Use risk events on higher risk projects
• You can use a combination of risk events and uncertainties
12

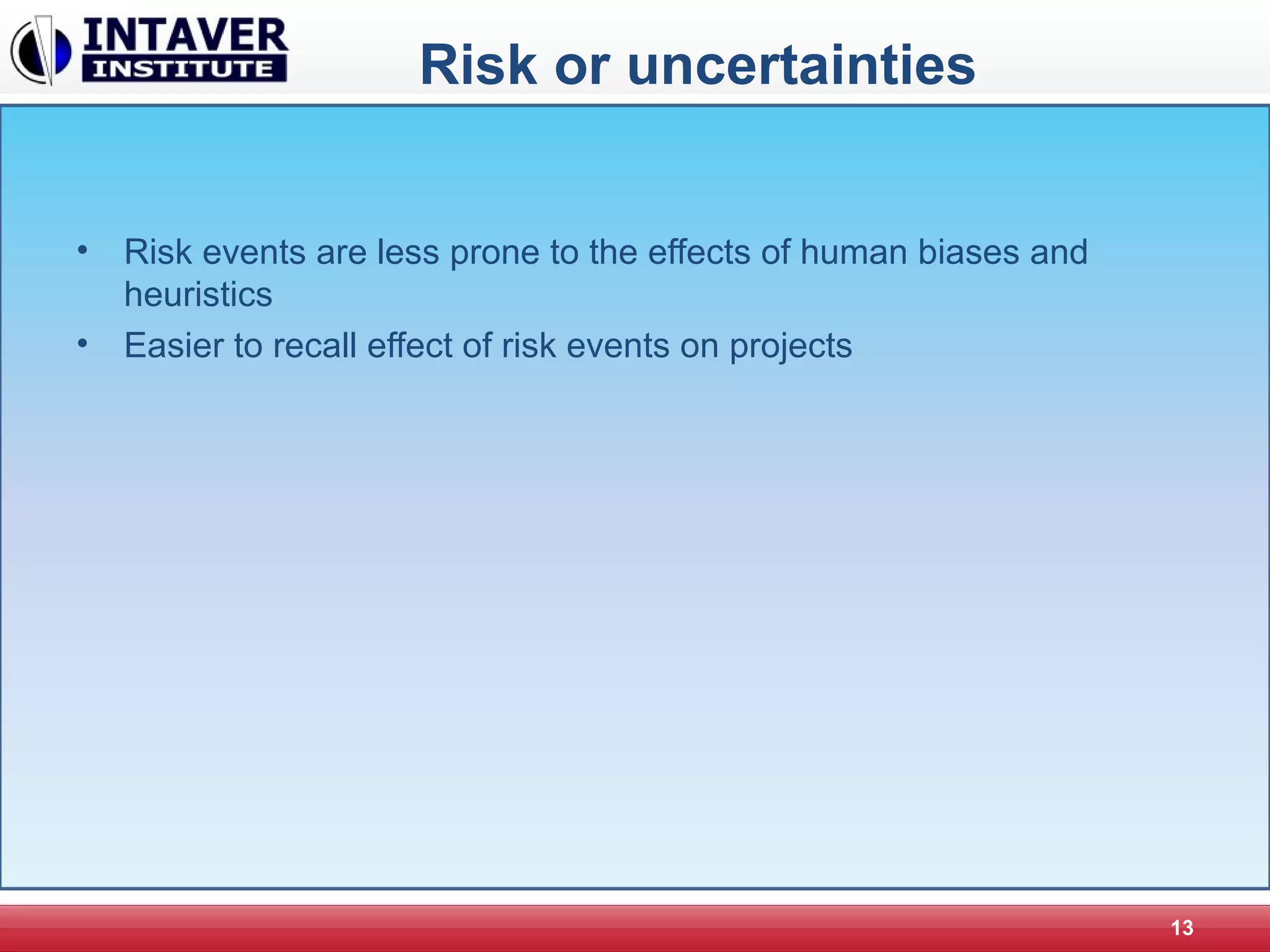

Risk or uncertainties
• Risk events are less prone to the effects of human biases and
heuristics
• Easier to recall effect of risk events on projects
13
Event Based Analysis
• Risk event estimates less affected by heuristics and biases
• Risk events estimates easier to obtain via relative frequency analysis
• Event based analysis of causes of project uncertainty
– Sensitivity analysis can be done to identify critical risks
– Uncertainties require additional root cause analysis to identify critical risks
14

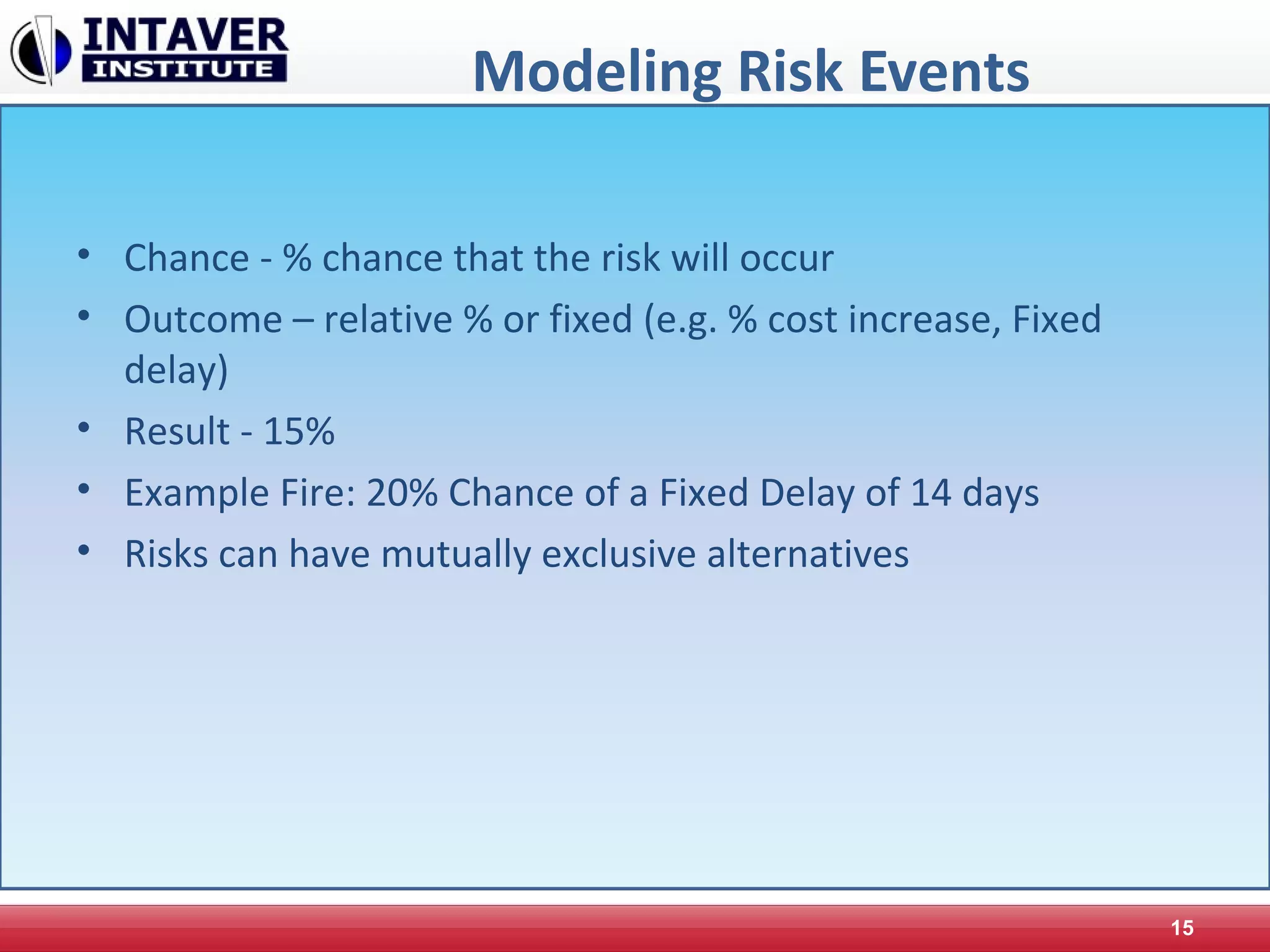

Modeling Risk Events
• Chance - % chance that the risk will occur
• Outcome – relative % or fixed (e.g. % cost increase, Fixed
delay)
• Result - 15%
• Example Fire: 20% Chance of a Fixed Delay of 14 days
• Risks can have mutually exclusive alternatives
15
Monte Carlo Analysis
• Statistical sampling
• Runs many simulations of a project that produces
probabilistic distributions of particular results (cost, duration,
finish time, etc.)
• Gaining popularity as size and power of hardware and
software improve
16

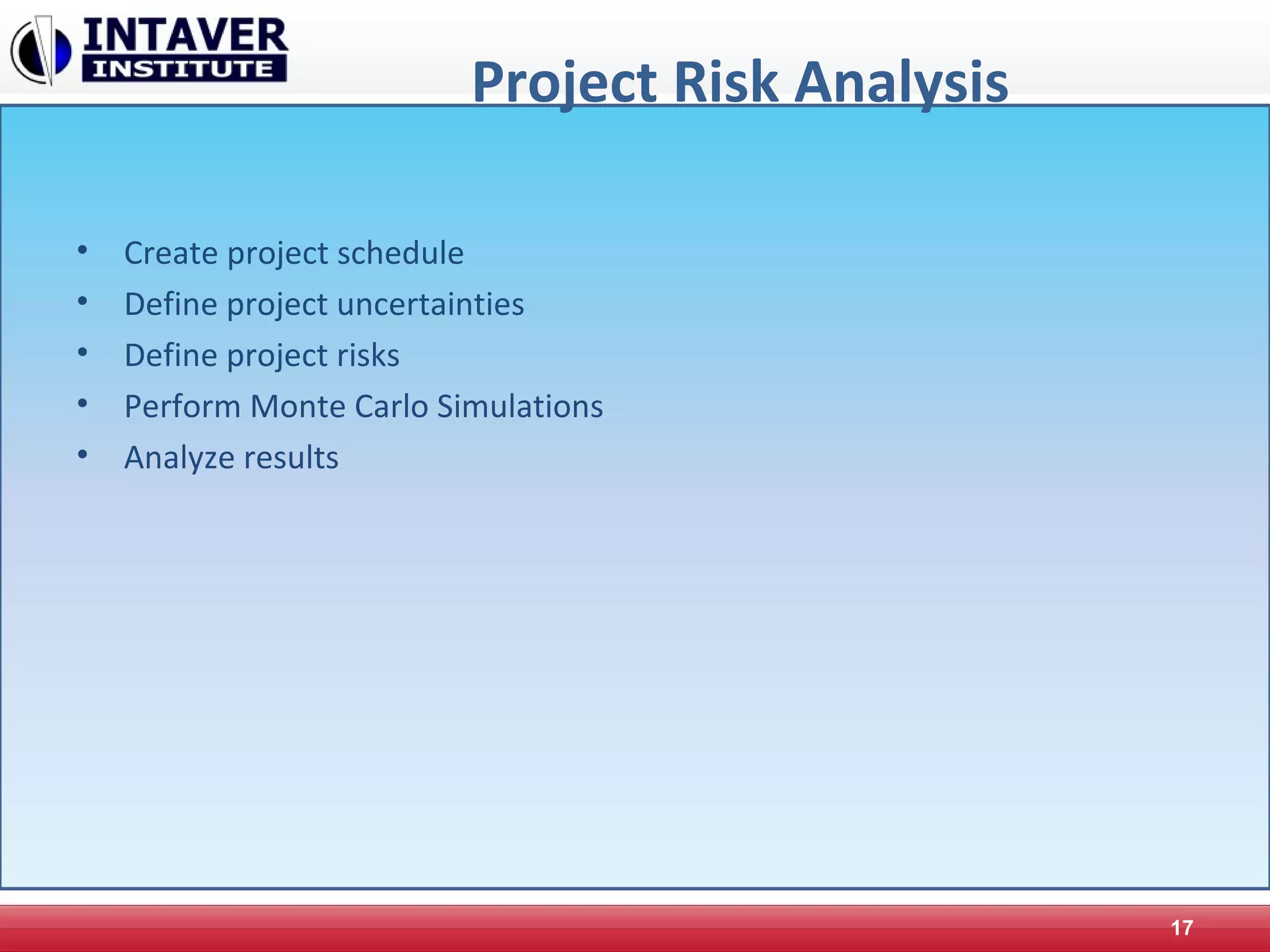

Project Risk Analysis
• Create project schedule
• Define project uncertainties
• Define project risks
• Perform Monte Carlo Simulations
• Analyze results
17

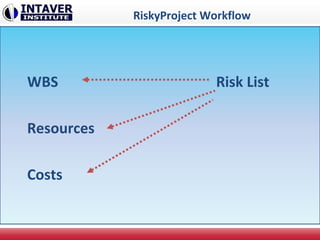

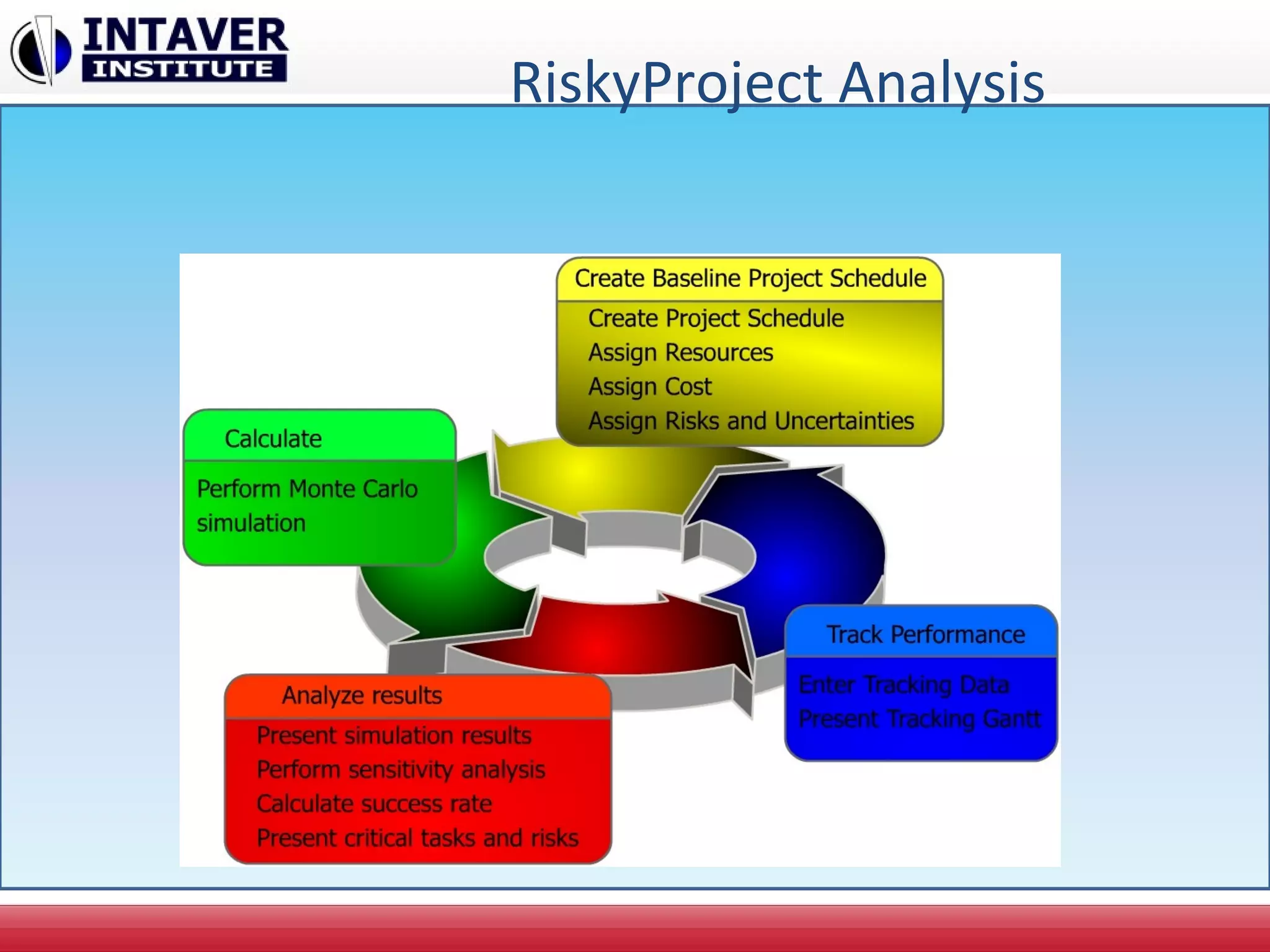

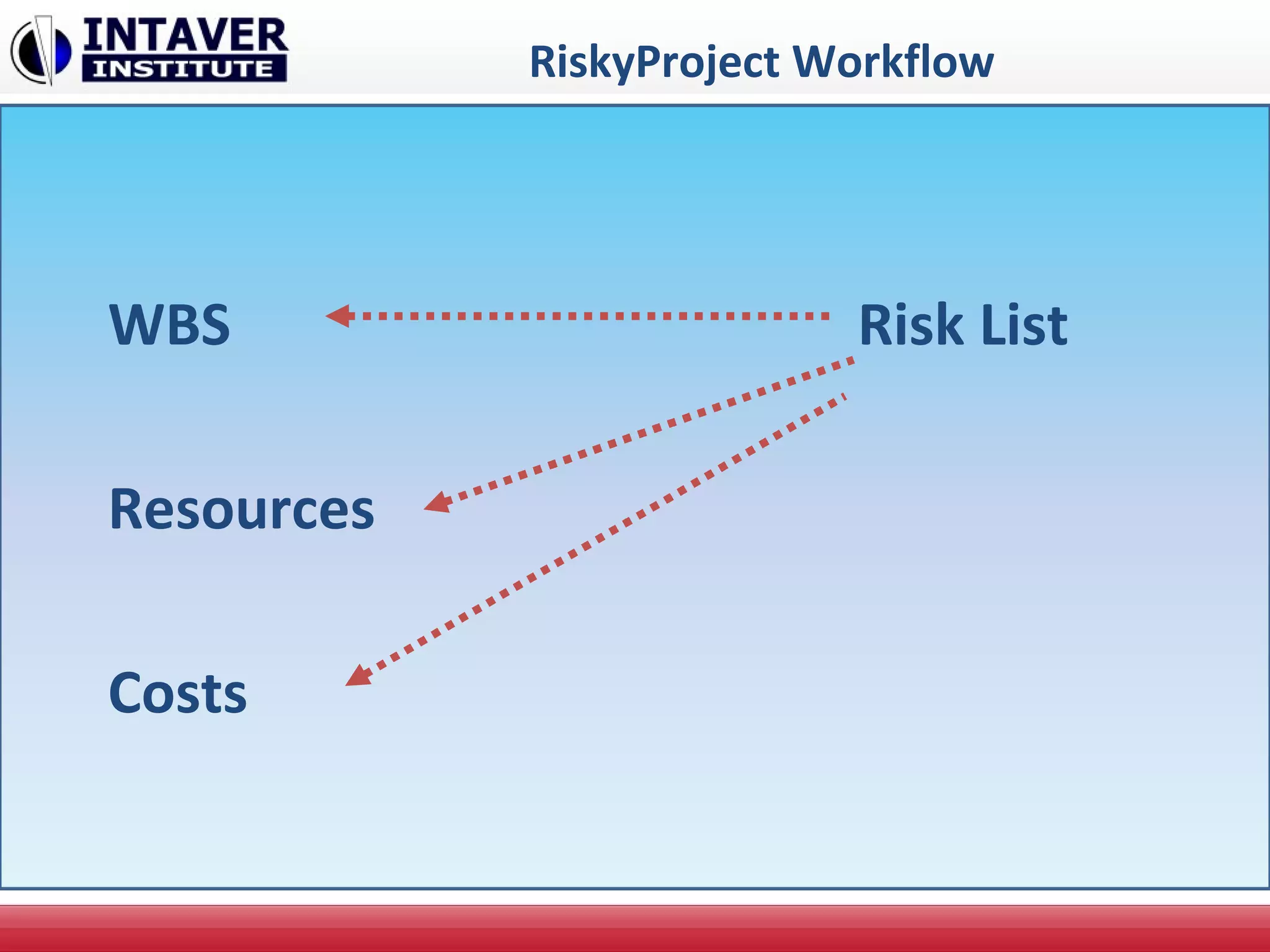

RiskyProject Workflow
WBS
Resources
Costs
Risk List
RiskyProject Analysis
Results of Analysis
• Project outcomes with and without risks and uncertainties
• Sensitivity analysis
• Cost analysis
• Identifying critical risks and uncertainties
• Success rates
20

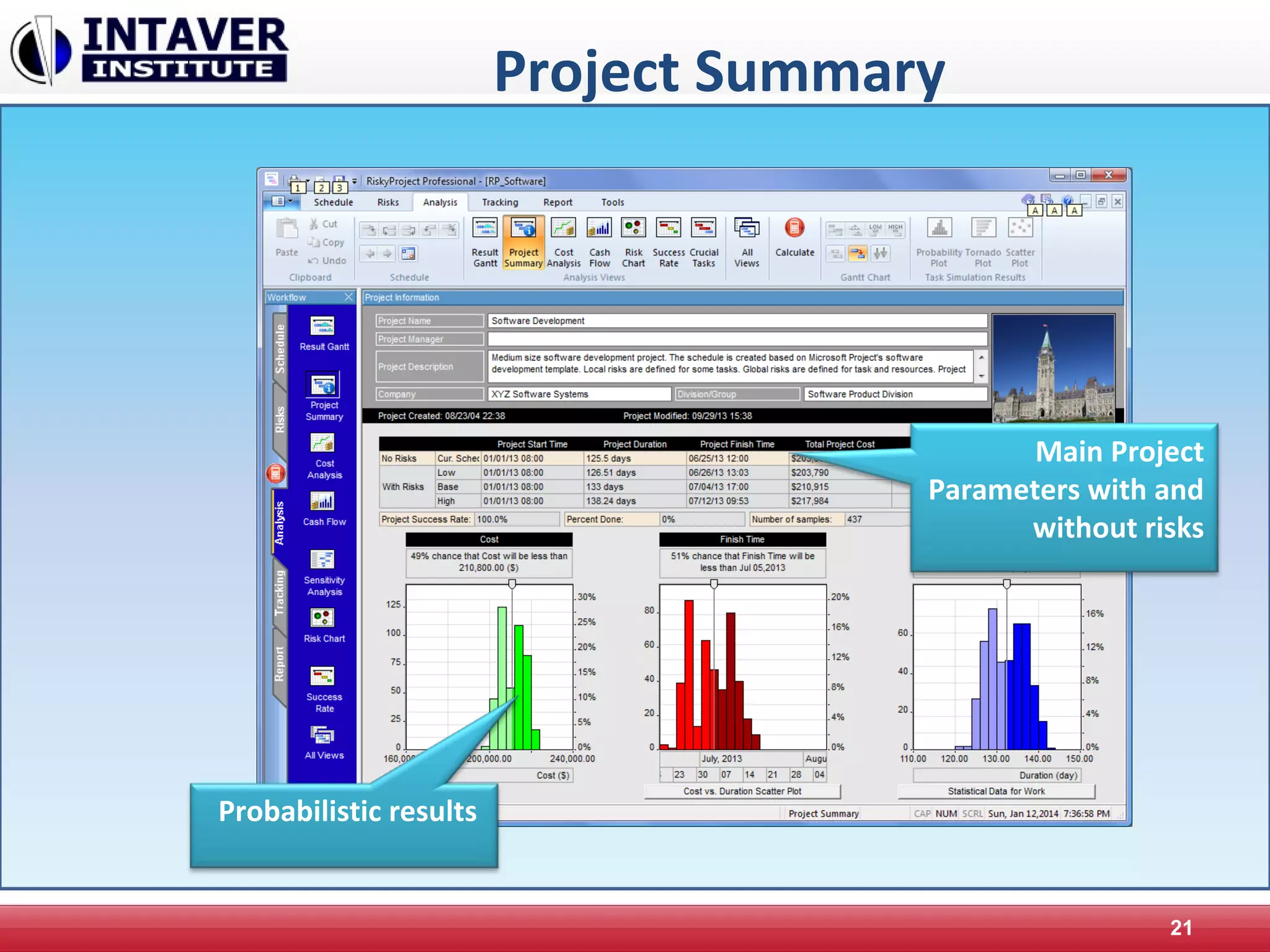

Project Summary
21
Main Project
Parameters with and
without risks
Probabilistic results

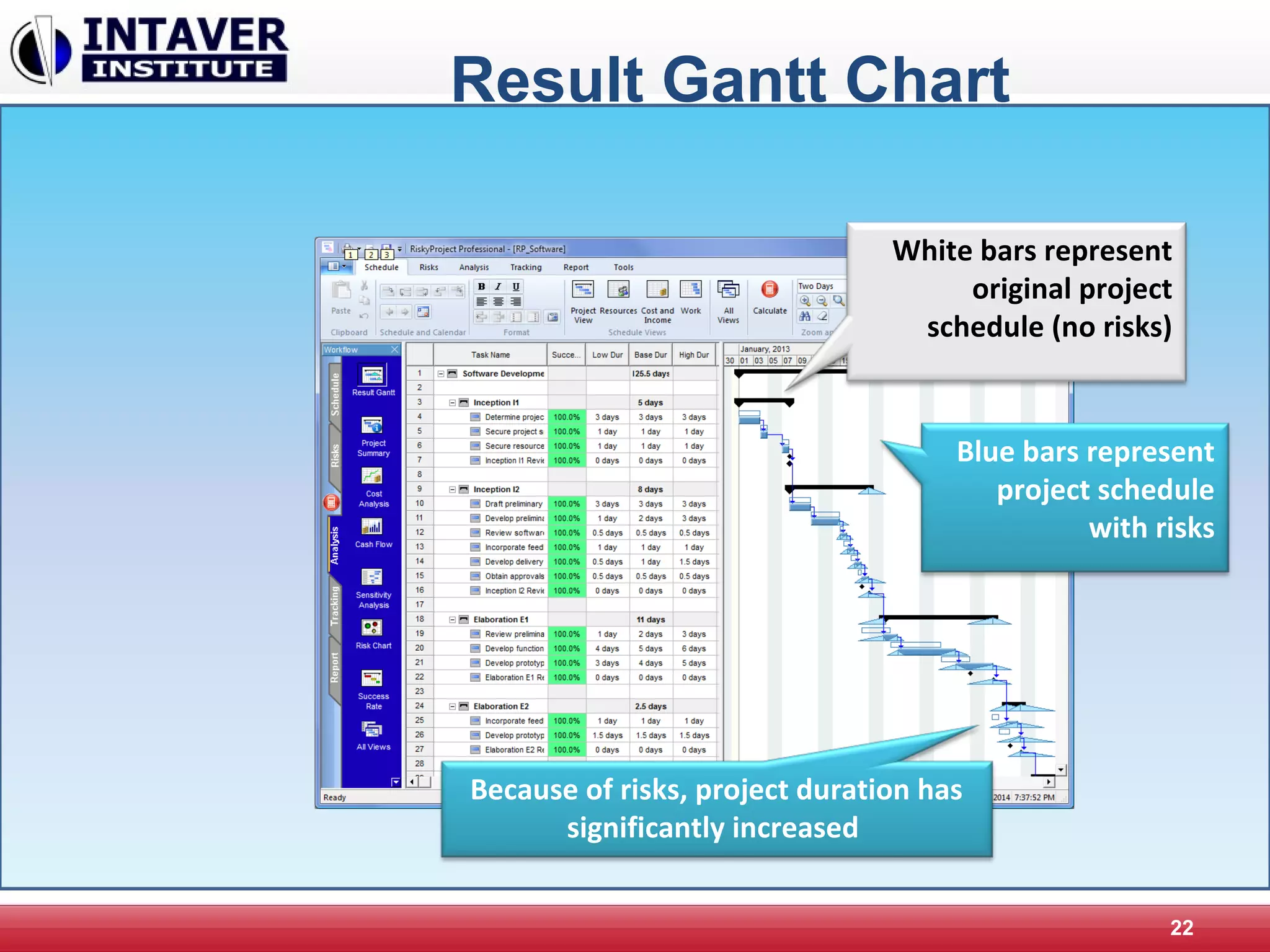

Result Gantt Chart
22
White bars represent
original project
schedule (no risks)
Blue bars represent
project schedule
with risks
Because of risks, project duration has
significantly increased

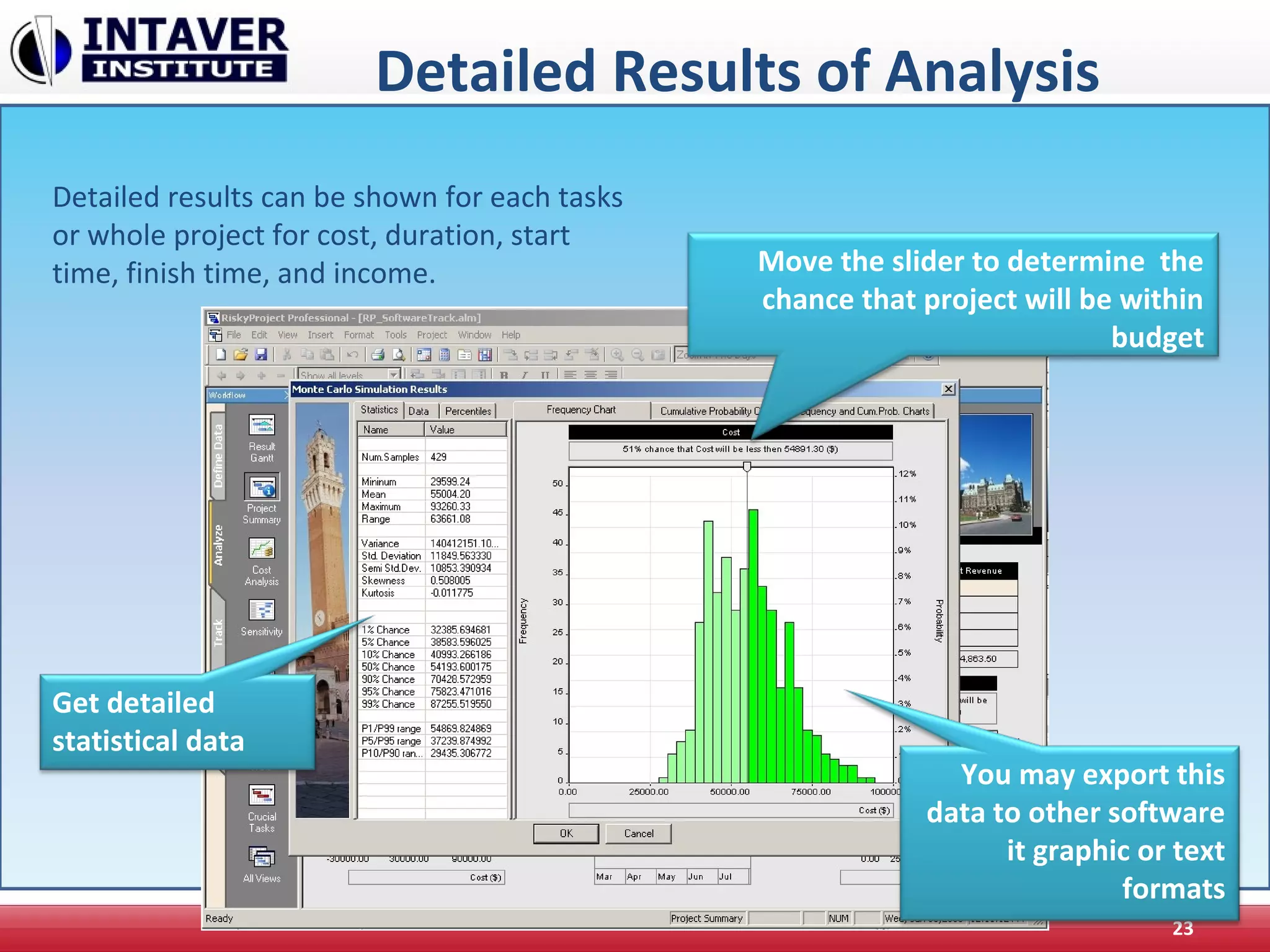

Detailed Results of Analysis
23
Move the slider to determine the
chance that project will be within
budget
Get detailed
statistical data
You may export this
data to other software
it graphic or text
formats
Detailed results can be shown for each tasks
or whole project for cost, duration, start
time, finish time, and income.

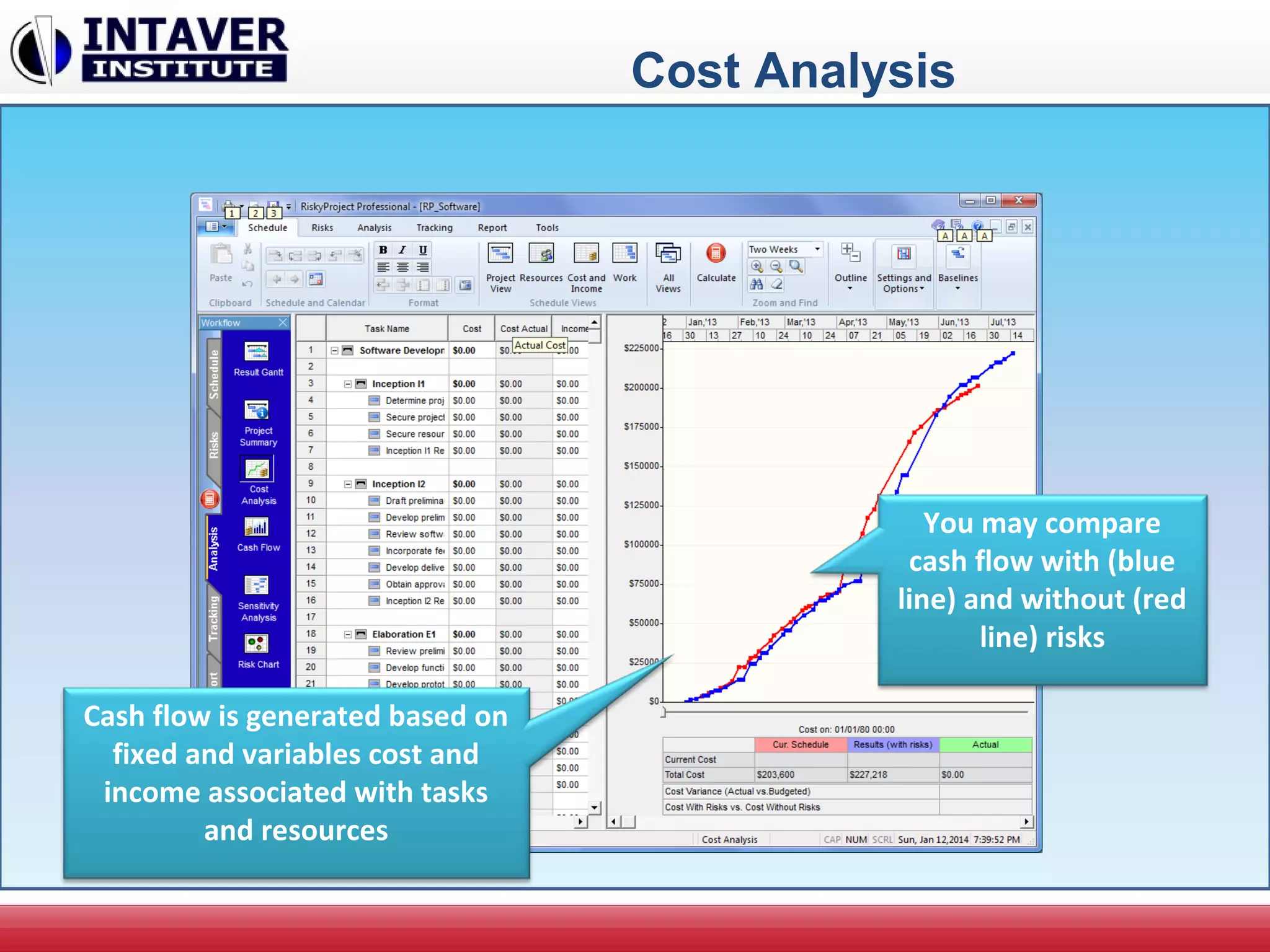

Cost Analysis
You may compare
cash flow with (blue
line) and without (red
line) risks
Cash flow is generated based on
fixed and variables cost and
income associated with tasks
and resources

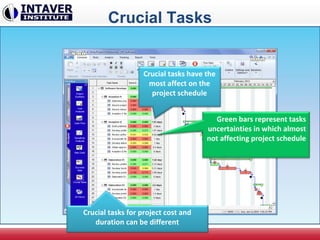

Crucial Tasks
Crucial tasks have the
most affect on the
project schedule
Green bars represent tasks
uncertainties in which almost
not affecting project schedule
Crucial tasks for project cost and
duration can be different

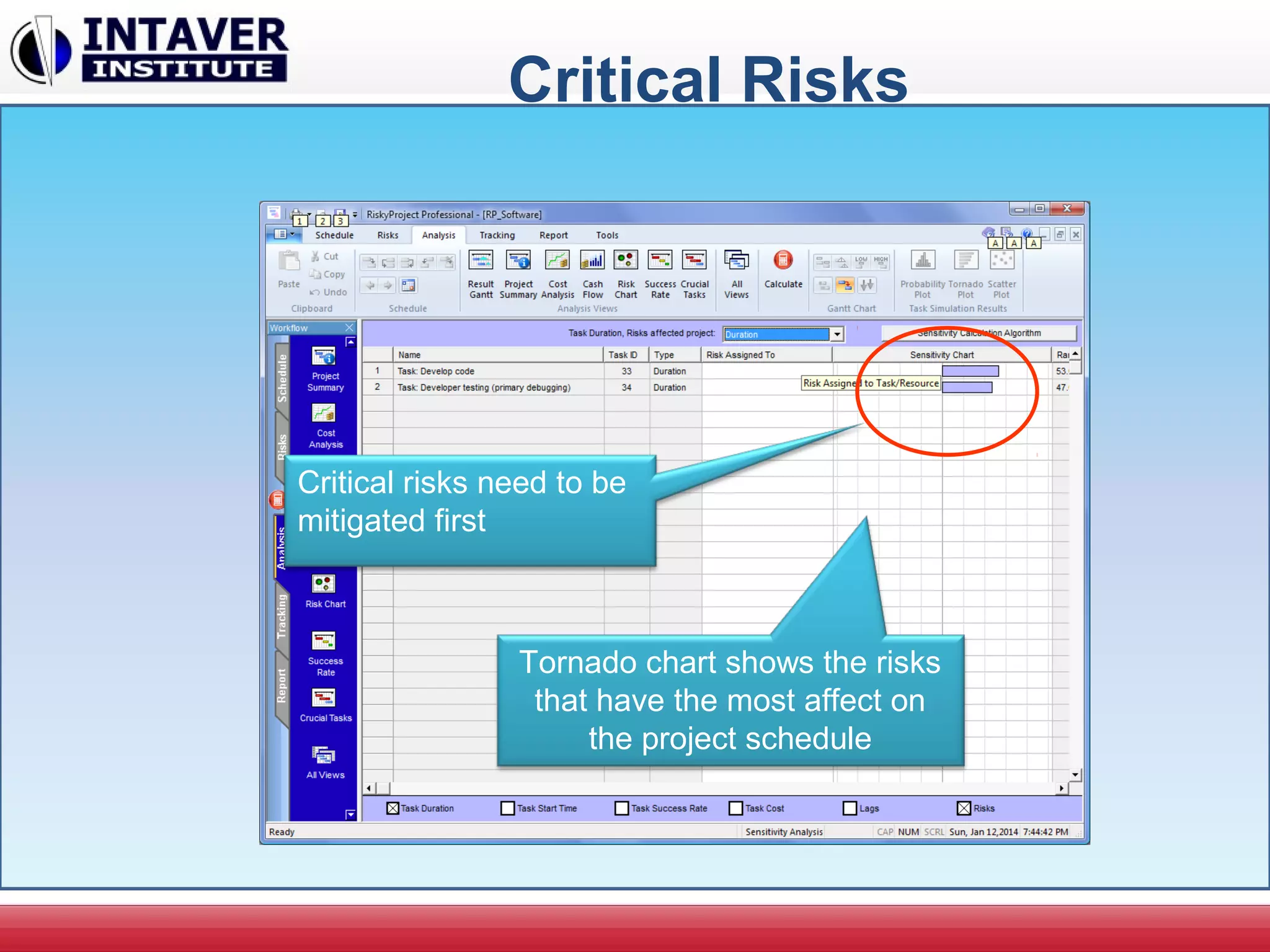

Critical Risks
Tornado chart shows the risks
that have the most affect on
the project schedule
Critical risks need to be
mitigated first

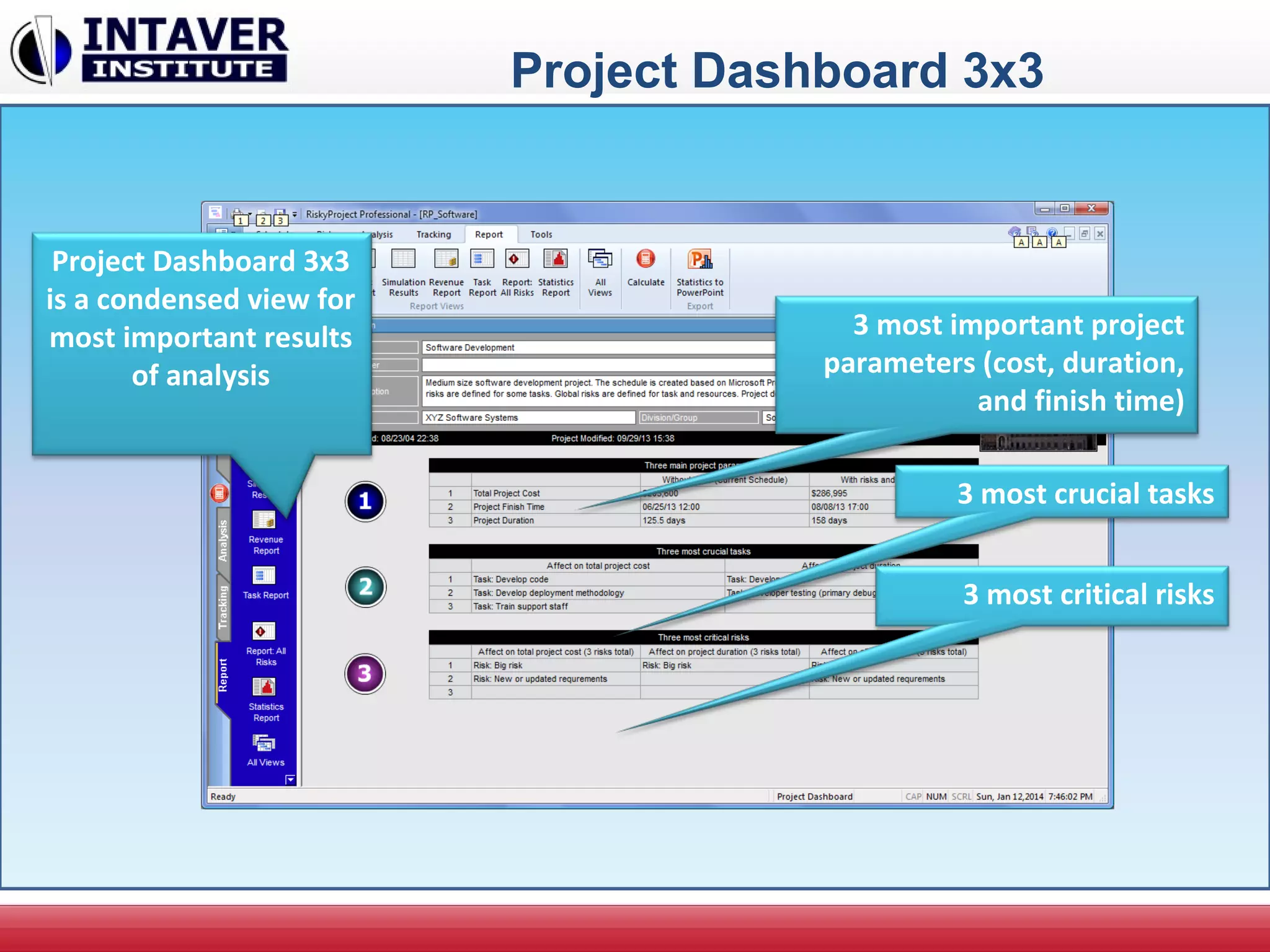

Project Dashboard 3x3
3 most important project
parameters (cost, duration,
and finish time)
3 most crucial tasks
3 most critical risks
Project Dashboard 3x3
is a condensed view for
most important results
of analysis

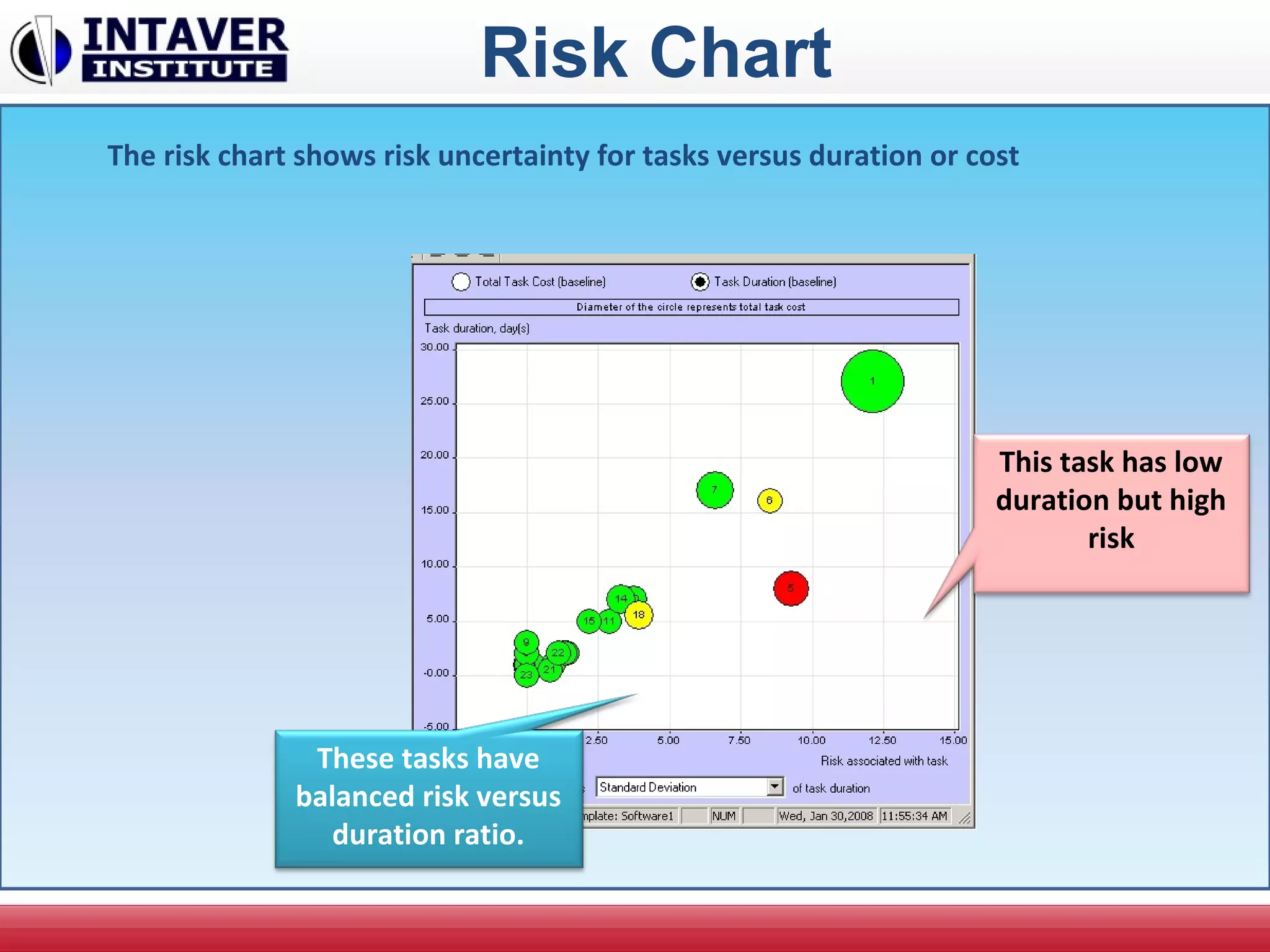

Risk Chart
The risk chart shows risk uncertainty for tasks versus duration or cost
This task has low
duration but high
risk
These tasks have
balanced risk versus
duration ratio.

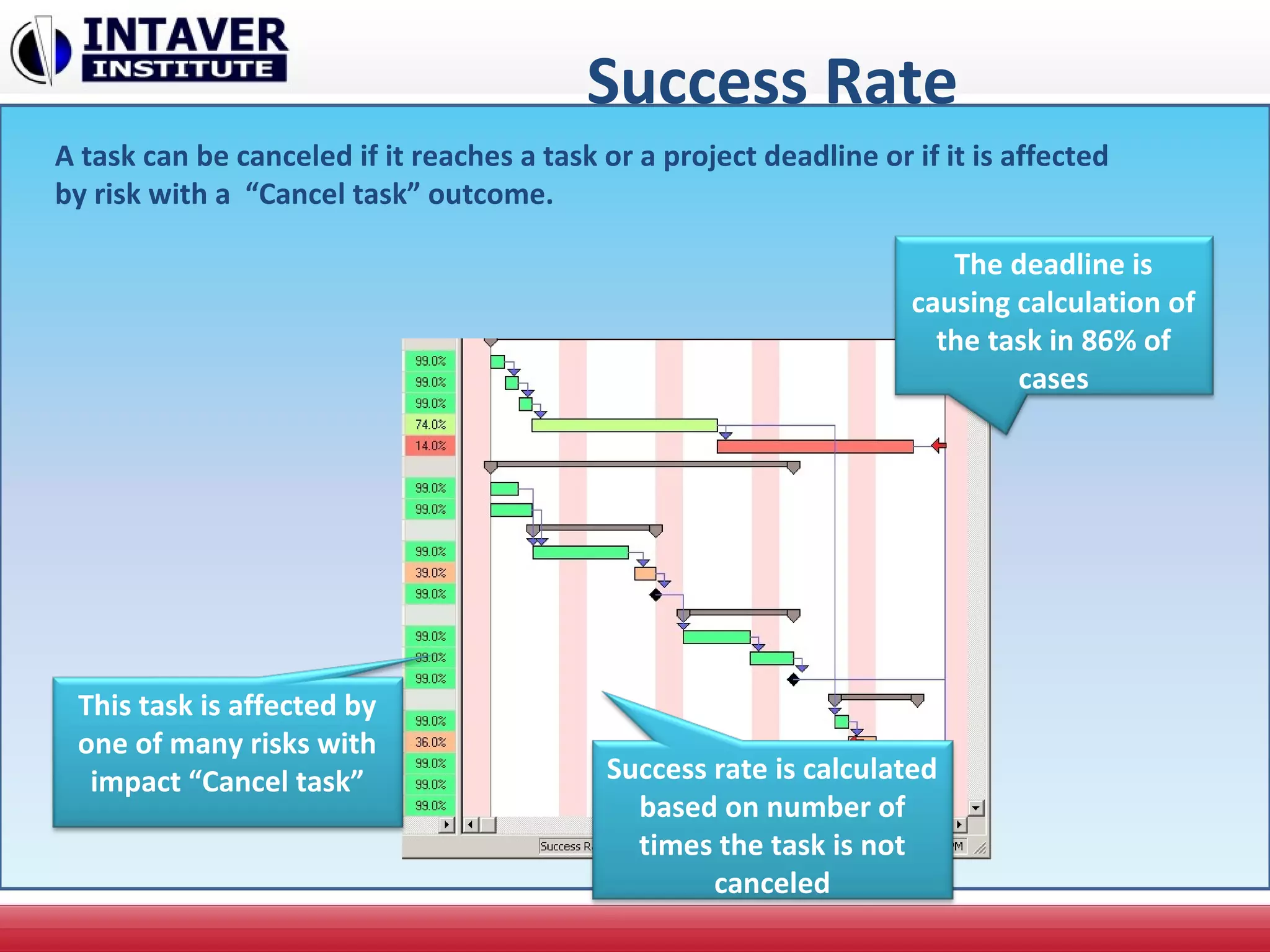

Success Rate
The deadline is
causing calculation of
the task in 86% of
cases
A task can be canceled if it reaches a task or a project deadline or if it is affected
by risk with a “Cancel task” outcome.
This task is affected by
one of many risks with
impact “Cancel task” Success rate is calculated
based on number of
times the task is not
canceled

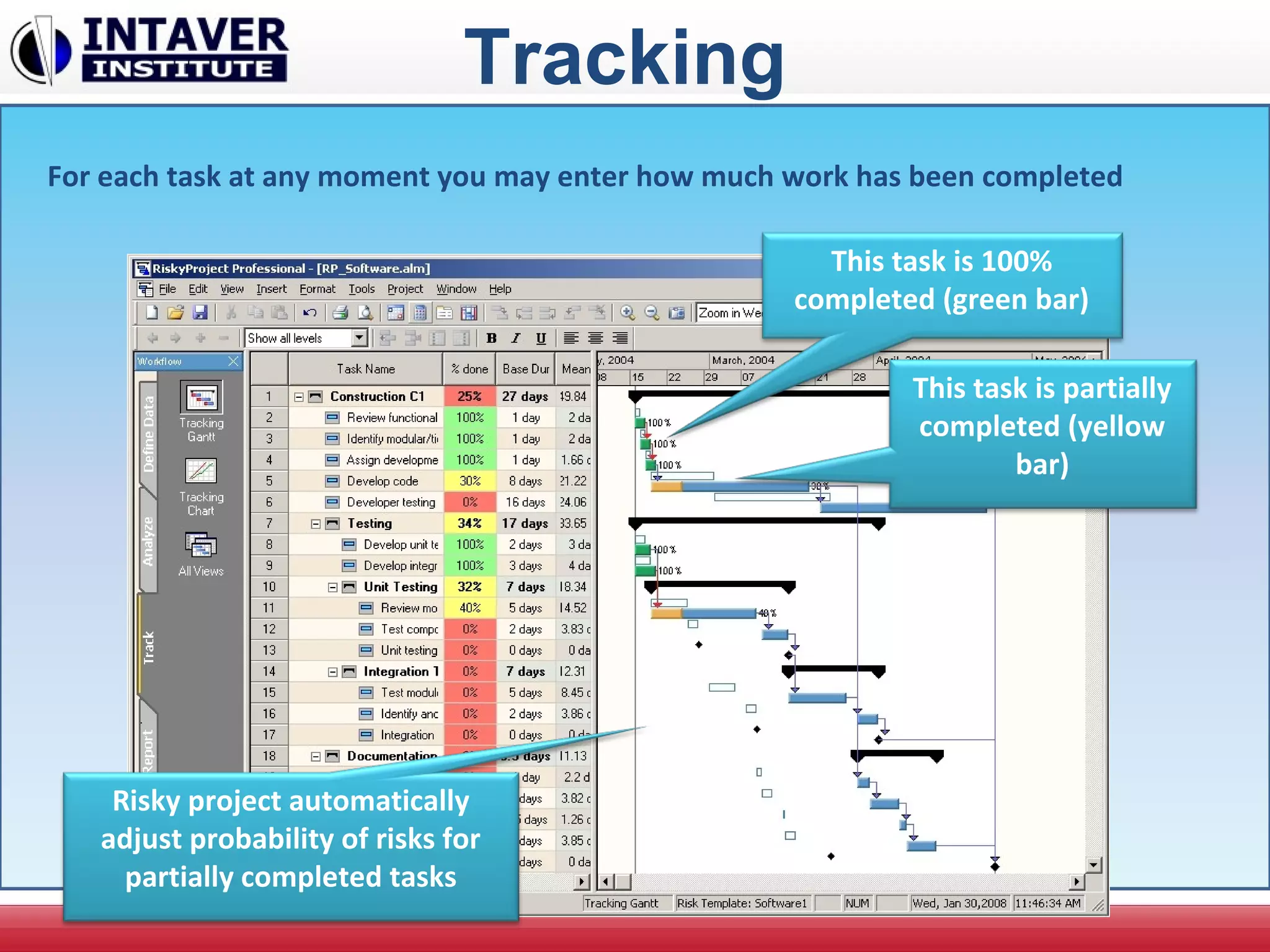

Tracking
This task is 100%
completed (green bar)
For each task at any moment you may enter how much work has been completed
This task is partially
completed (yellow
bar)
Risky project automatically
adjust probability of risks for
partially completed tasks

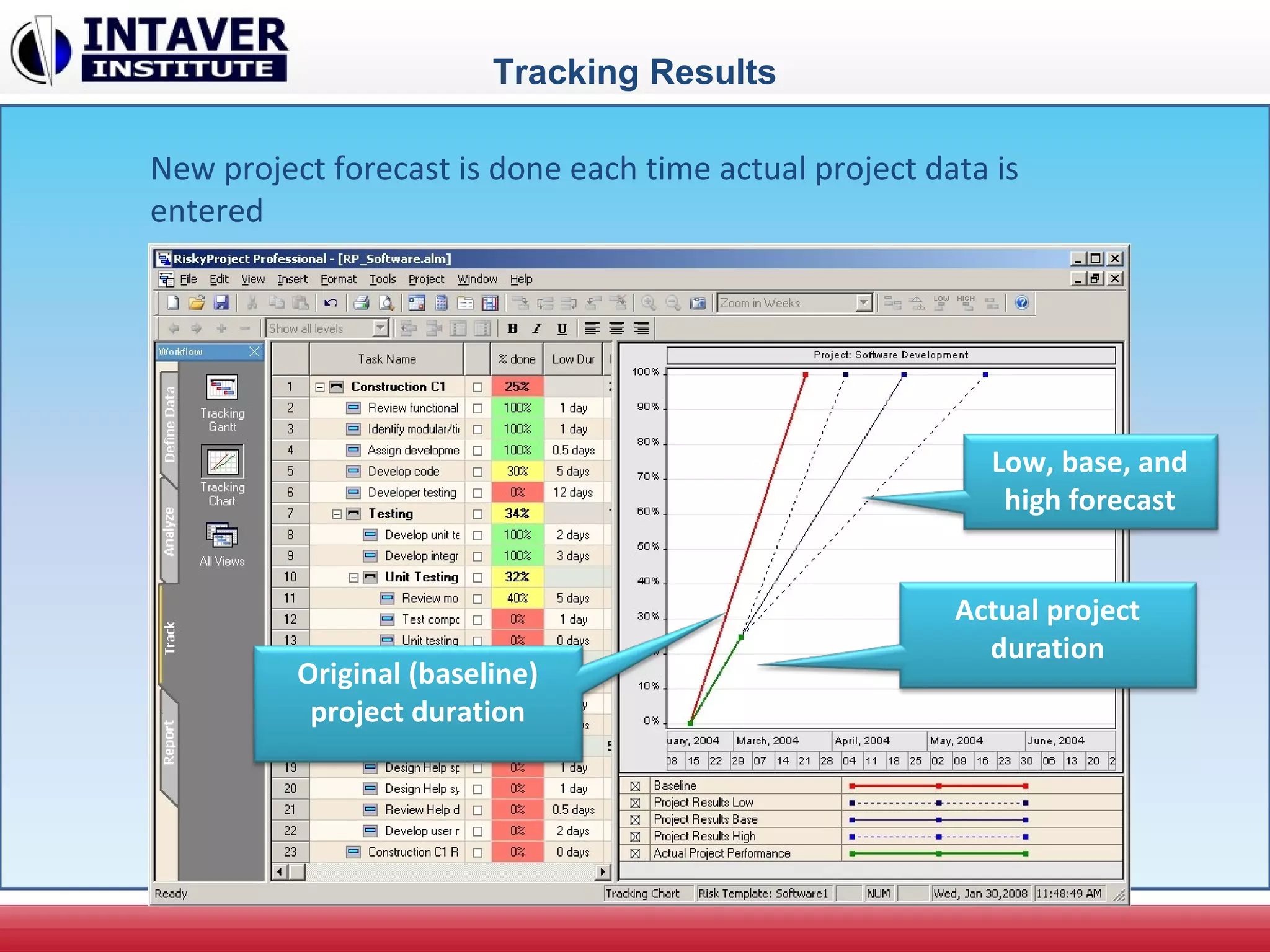

Tracking Results
New project forecast is done each time actual project data is
entered
Original (baseline)
project duration
Actual project
duration
Low, base, and
high forecast
Intaver Institute
32
Intaver Institute performs project risk management, risk
analysis, and decision analysis training and consulting
Download a trial version of RiskyProject at:
http://www.intaver.com/index-downloads.html (version 2.1)
White papers, presentations : http://www.intaver.com/index-
whitepapers.html
Courses: http://www.intaver.com/riskyproject_training.html
Future Reading
Lev Virine and Michael Trumper
Project Decisions:
The Art and Science
Management Concepts, Vienna, VA, 2007
Lev Virine and Michael Trumper
Project Think:
Why Good Managers Make Poor Project Choices
Gower, 2013
