Risk Management
Martin Sillaots
2019
# 10
Risk Definition
An uncertain event or condition that, if occurs
has a positive or negative effect on project
duration, cost, scope or quality
www.projektor.ee/pm/#risk

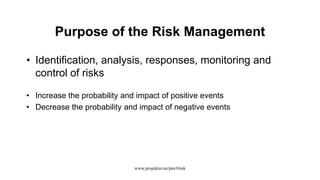

Purpose of the Risk Management
• Identification, analysis, responses, monitoring and
control of risks
• Increase the probability and impact of positive events
• Decrease the probability and impact of negative events
www.projektor.ee/pm/#risk

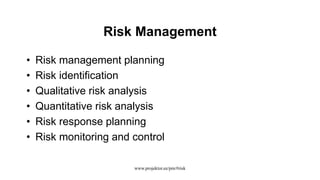

Risk Management
• Risk management planning
• Risk identification
• Qualitative risk analysis
• Quantitative risk analysis
• Risk response planning
• Risk monitoring and control
www.projektor.ee/pm/#risk

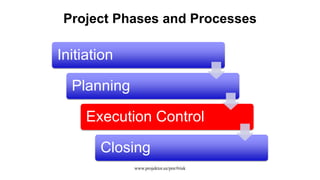

Project Phases and Processes
Initiation
Planning
Execution Control
Closing
www.projektor.ee/pm/#risk

Risk Management in the Project Plan
Scope
definition
Quality
planning
Activity
definition
Activity
sequencing
Duration
estimation
Schedule
development
Organization
planning
Resource
planning
Communica-
tion planning
Procurement
planning
Plan
contracting
Select
sellers
Seller
responses
Risk
management
Risk
identification
Qualitative
analysis
Quantitative
analysis
Response
planning
Budgeting
Project
plan
Initiation
Execution
WBS
www.projektor.ee/pm/#risk

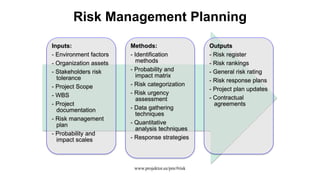

Inputs:
- Environment factors
- Organization assets
- Stakeholders risk
tolerance
- Project Scope
- WBS
- Project
documentation
- Risk management
plan
- Probability and
impact scales
Methods:
- Identification
methods
- Probability and
impact matrix
- Risk categorization
- Risk urgency
assessment
- Data gathering
techniques
- Quantitative
analysis techniques
- Response strategies
Outputs
- Risk register
- Risk rankings
- General risk rating
- Risk response plans
- Project plan updates
- Contractual
agreements
Risk Management Planning
www.projektor.ee/pm/#risk
Inputs
Risk Management Planning
www.projektor.ee/pm/#risk

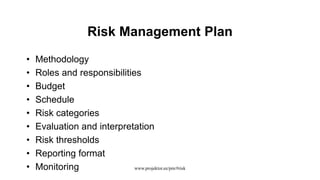

Risk Management Plan
• Methodology
• Roles and responsibilities
• Budget
• Schedule
• Risk categories
• Evaluation and interpretation
• Risk thresholds
• Reporting format
• Monitoring www.projektor.ee/pm/#risk
RBS – Risk Breakdown Structure
BMBOK Guide 2009
Methods
Risk Management Planning
www.projektor.ee/pm/#risk

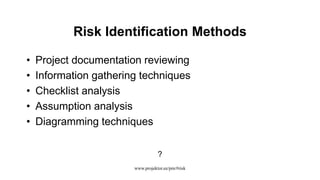

Risk Identification Methods
• Project documentation reviewing
• Information gathering techniques
• Checklist analysis
• Assumption analysis
• Diagramming techniques
?
www.projektor.ee/pm/#risk
SWOT Analysis
Positive Negative
Internal Strengths Weaknesses
External Opportunities Threats
www.projektor.ee/pm/#risk

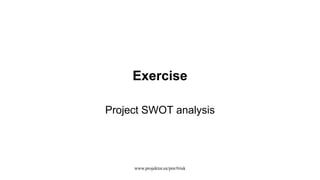

Exercise
Project SWOT analysis
www.projektor.ee/pm/#risk

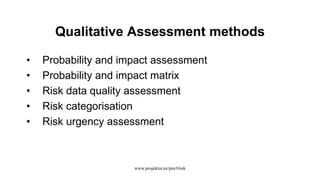

Qualitative Assessment methods
• Probability and impact assessment
• Probability and impact matrix
• Risk data quality assessment
• Risk categorisation
• Risk urgency assessment
www.projektor.ee/pm/#risk

Risk Probability and Impact Matrix 1
Probability:
Impact:
Big 0,7 Average 0,5 Small 0,3
Big 0,7 0,49 0,35 0,21
Average 0,5 0,35 0,25 0,15
Small 0,3 0,21 0,15 0,09
www.projektor.ee/pm/#risk

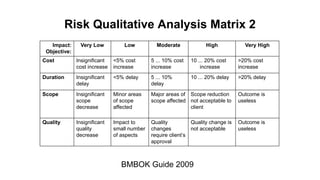

Risk Qualitative Analysis Matrix 2
Impact:
Objective:
Very Low Low Moderate High Very High
Cost Insignificant
cost increase
<5% cost
increase
5 ... 10% cost
increase
10 ... 20% cost
increase
>20% cost
increase
Duration Insignificant
delay
<5% delay 5 ... 10%
delay
10 ... 20% delay >20% delay
Scope Insignificant
scope
decrease
Minor areas
of scope
affected
Major areas of
scope affected
Scope reduction
not acceptable to
client
Outcome is
useless
Quality Insignificant
quality
decrease
Impact to
small number
of aspects
Quality
changes
require client’s
approval
Quality change is
not acceptable
Outcome is
useless
BMBOK Guide 2009
Exercise
Probability and impact matrix of project risks
www.projektor.ee/pm/#risk

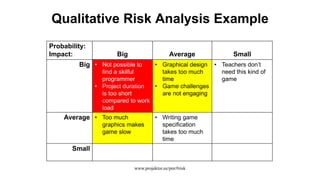

Qualitative Risk Analysis Example
Probability:
Impact: Big Average Small
Big • Not possible to
find a skilful
programmer
• Project duration
is too short
compared to work
load
• Graphical design
takes too much
time
• Game challenges
are not engaging
• Teachers don’t
need this kind of
game
Average • Too much
graphics makes
game slow
• Writing game
specification
takes too much
time
Small
www.projektor.ee/pm/#risk

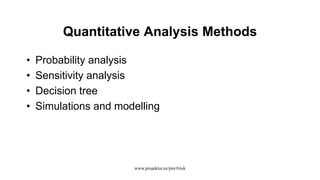

Quantitative Analysis Methods
• Probability analysis
• Sensitivity analysis
• Decision tree
• Simulations and modelling
www.projektor.ee/pm/#risk
E.G: Three Point Estimation
BMBOK Guide 2009

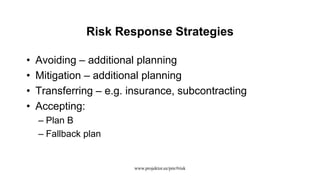

Risk Response Strategies
• Avoiding – additional planning
• Mitigation – additional planning
• Transferring – e.g. insurance, subcontracting
• Accepting:
– Plan B
– Fallback plan
www.projektor.ee/pm/#risk
Outputs
Risk Management Planning
www.projektor.ee/pm/#risk

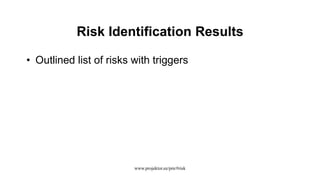

Risk Identification Results
• Outlined list of risks with triggers
www.projektor.ee/pm/#risk
Outcomes of Qualitative Risk Analysis
• Ordered list of risks
• General risk rating
• List of risks that require additional investigation
• Trends of risk analysis
www.projektor.ee/pm/#risk

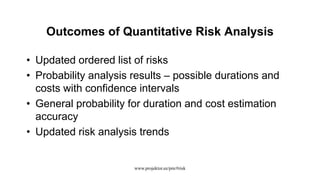

Outcomes of Quantitative Risk Analysis
• Updated ordered list of risks
• Probability analysis results – possible durations and
costs with confidence intervals
• General probability for duration and cost estimation
accuracy
• Updated risk analysis trends
www.projektor.ee/pm/#risk
Risk Response Planning Results
• Risk responses
• Residual risk
• Secondary risks
• Contractual agreements
• Project plan updates
www.projektor.ee/pm/#risk

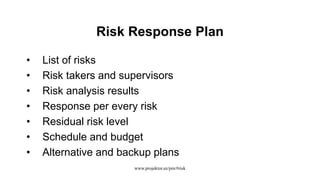

Risk Response Plan
• List of risks
• Risk takers and supervisors
• Risk analysis results
• Response per every risk
• Residual risk level
• Schedule and budget
• Alternative and backup plans
www.projektor.ee/pm/#risk

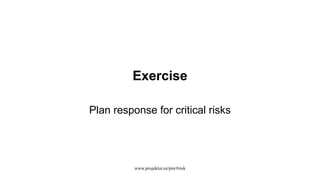

Exercise
Plan response for critical risks
www.projektor.ee/pm/#risk

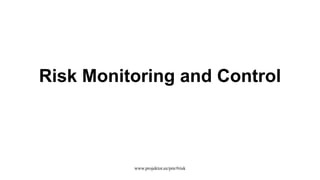

Risk Monitoring and Control
www.projektor.ee/pm/#risk

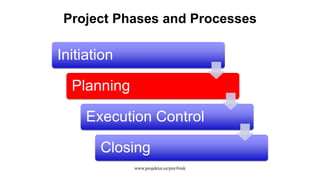

Project Phases and Processes
Initiation
Planning
Execution Control
Closing
www.projektor.ee/pm/#risk
Risk Monitoring and Control
Information
distribution
Project
execution
Procurement
management
Reporting
Team
development
Schedule
control
Scope
verification
Cost
control
Quality
control
Risk
monitoring
Change
management
Planning
Closing
www.projektor.ee/pm/#risk

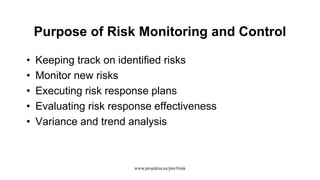

Purpose of Risk Monitoring and Control
• Keeping track on identified risks
• Monitor new risks
• Executing risk response plans
• Evaluating risk response effectiveness
• Variance and trend analysis
www.projektor.ee/pm/#risk

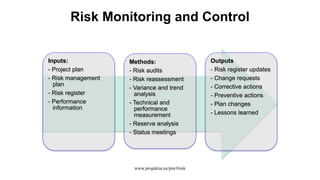

Inputs:
- Project plan
- Risk management
plan
- Risk register
- Performance
information
Methods:
- Risk audits
- Risk reassessment
- Variance and trend
analysis
- Technical and
performance
measurement
- Reserve analysis
- Status meetings
Outputs
- Risk register updates
- Change requests
- Corrective actions
- Preventive actions
- Plan changes
- Lessons learned
Risk Monitoring and Control
www.projektor.ee/pm/#risk

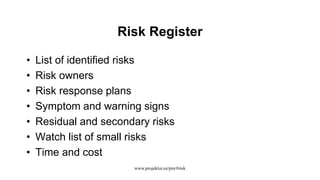

Risk Register
• List of identified risks
• Risk owners
• Risk response plans
• Symptom and warning signs
• Residual and secondary risks
• Watch list of small risks
• Time and cost
www.projektor.ee/pm/#risk
Risk Register Example
www.projektor.ee/pm/#risk
www.projektor.ee/pm/#risk
The end of the Risk
