Practical Process Improvement
    using Lean and Six Sigma

        A 1-day workshop for the OR Society
        Facilitated by Ian J Seath

1                 © 2011 Copyright ISC Ltd.

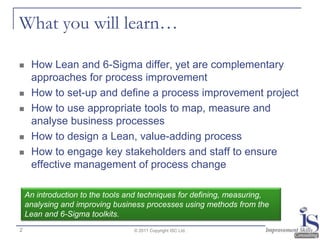

What you will learn…

    How Lean and 6-Sigma differ, yet are complementary
     approaches for process improvement
    How to set-up and define a process improvement project
    How to use appropriate tools to map, measure and
     analyse business processes
    How to design a Lean, value-adding process
    How to engage key stakeholders and staff to ensure
     effective management of process change

    An introduction to the tools and techniques for defining, measuring,
    analysing and improving business processes using methods from the
    Lean and 6-Sigma toolkits.
2                                 © 2011 Copyright ISC Ltd.
Is that an “active banana” or an
“inactive banana” on your desk?

3              © 2011 Copyright ISC Ltd.
What is a Process?

       Processes take INPUTS, do WORK to them, and produce OUTPUTS for
        CUSTOMERS

        Input                        Process                    Output

       They exist to achieve performance OUTCOMES (for the benefit of
        customers or stakeholders)

4                                © 2011 Copyright ISC Ltd.
Focus of improvement
      Cheaper                                                     Happier
                                                                 Customers

                  Efficient                          Effective
     Less Waste                                                        Better

       More                                                             More Reliable
    Responsive    Flexible
                                                     Capable
                  & Agile
       Faster                                                     More Capacity

5                             © 2011 Copyright ISC Ltd.

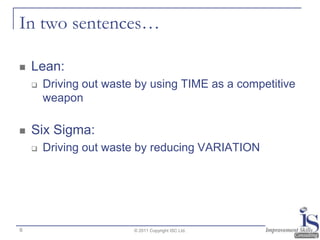

In two sentences…

   Lean:
       Driving out waste by using TIME as a competitive
        weapon

   Six Sigma:
       Driving out waste by reducing VARIATION

6                        © 2011 Copyright ISC Ltd.

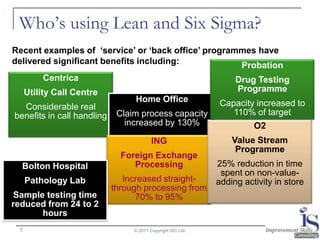

Who’s using Lean and Six Sigma?
Recent examples of ‘service’ or ‘back office’ programmes have
delivered significant benefits including:            Probation
         Centrica                                                 Drug Testing
     Utility Call Centre                                          Programme
                                 Home Office                  Capacity increased to
  Considerable real
benefits in call handling    Claim process capacity              110% of target
                               increased by 130%                       O2
                                         ING                     Value Stream
                                                                  Programme
                              Foreign Exchange
  Bolton Hospital                Processing                  25% reduction in time
                                                              spent on non-value-
     Pathology Lab             Increased straight-           adding activity in store
                            through processing from
Sample testing time               70% to 95%
reduced from 24 to 2
      hours
 7                               © 2011 Copyright ISC Ltd.

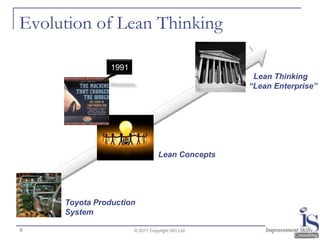

Evolution of Lean Thinking

                1991
                                                    Lean Thinking
                                                   “Lean Enterprise”

                                  Lean Concepts

     Toyota Production
     System

8                      © 2011 Copyright ISC Ltd.

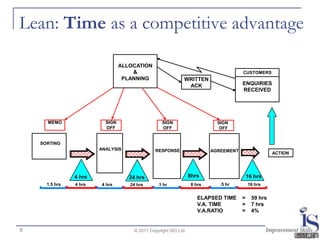

Lean: Time as a competitive advantage

                                 ALLOCATION
                                     &                                                CUSTOMERS
                                  PLANNING                    WRITTEN
                                                               ACK                    ENQUIRIES
                                                                                      RECEIVED

      MEMO                SIGN                     SIGN                     SIGN
                          OFF                      OFF                       OFF

    SORTING
                        ANALYSIS                RESPONSE                  AGREEMENT
                                                                                                     ACTION

                4 hrs               24 hrs                        8hrs                    16 hrs
      1.5 hrs   4 hrs    4 hrs      24 hrs       1 hr             8 hrs      .5 hr        16 hrs

                                                                     ELAPSED TIME     =     59 hrs
                                                                     V.A. TIME        =     7 hrs
                                                                     V.A.RATIO        =     4%

9                                     © 2011 Copyright ISC Ltd.
                                                                                                              20M_16

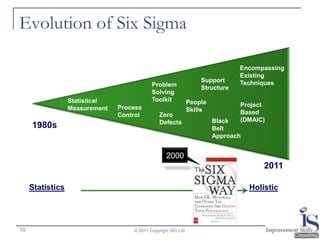

Evolution of Six Sigma

                                                                                Encompassing
                                                                                Existing
                                                                    Support     Techniques
                                            Problem                 Structure
                                            Solving
                  Statistical               Toolkit             People
                                Process                                         Project
                  Measurement                                   Skills
                                Control         Zero                            Based
                                                Defects                  Black  (DMAIC)
     1980s                                                               Belt
                                                                         Approach

                                                   2000
                                                                                        2011

     Statistics                                                                     Holistic

10                                  © 2011 Copyright ISC Ltd.

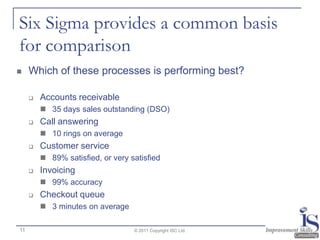

Six Sigma provides a common basis
for comparison
    Which of these processes is performing best?

        Accounts receivable
          35 days sales outstanding (DSO)
        Call answering
          10 rings on average
        Customer service
          89% satisfied, or very satisfied
        Invoicing
          99% accuracy
        Checkout queue
          3 minutes on average

11                                 © 2011 Copyright ISC Ltd.
6 Sigma: Customers feel the Variance,
not the Mean
                On average
     Supplier   our rope is
                2 cm thick !

                That‟s good
     Customer
                 to know!

12                      © 2011 Copyright ISC Ltd.

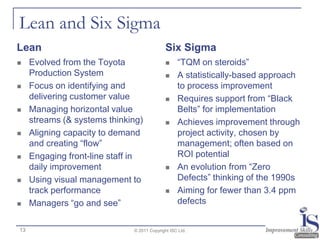

Lean and Six Sigma
Lean                                         Six Sigma
    Evolved from the Toyota                     “TQM on steroids”
     Production System                           A statistically-based approach
    Focus on identifying and                     to process improvement
     delivering customer value                   Requires support from “Black
    Managing horizontal value                    Belts” for implementation
     streams (& systems thinking)                Achieves improvement through
    Aligning capacity to demand                  project activity, chosen by
     and creating “flow”                          management; often based on
    Engaging front-line staff in                 ROI potential
     daily improvement                           An evolution from “Zero
    Using visual management to                   Defects” thinking of the 1990s
     track performance                           Aiming for fewer than 3.4 ppm
    Managers “go and see”                        defects

13                            © 2011 Copyright ISC Ltd.

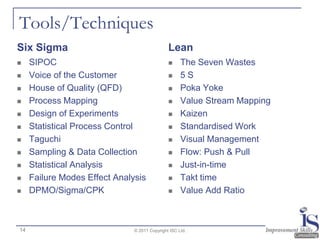

Tools/Techniques
Six Sigma                                      Lean
    SIPOC                                          The Seven Wastes
    Voice of the Customer                          5S
    House of Quality (QFD)                         Poka Yoke
    Process Mapping                                Value Stream Mapping
    Design of Experiments                          Kaizen
    Statistical Process Control                    Standardised Work
    Taguchi                                        Visual Management
    Sampling & Data Collection                     Flow: Push & Pull
    Statistical Analysis                           Just-in-time
    Failure Modes Effect Analysis                  Takt time
    DPMO/Sigma/CPK                                 Value Add Ratio

14                             © 2011 Copyright ISC Ltd.

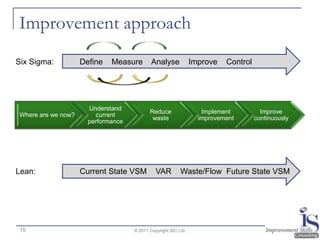

Improvement approach
Six Sigma:          Define   Measure        Analyse             Improve   Control

                      Understand
                                           Reduce                  Implement          Improve
Where are we now?       current
                                            waste                 improvement       continuously
                      performance

Lean:               Current State VSM         VAR         Waste/Flow Future State VSM

 15                                 © 2011 Copyright ISC Ltd.

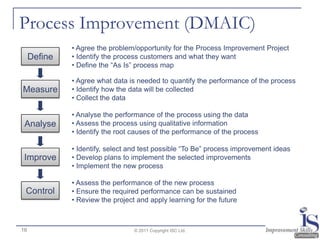

Process Improvement (DMAIC)
              • Agree the problem/opportunity for the Process Improvement Project
     Define   • Identify the process customers and what they want
              • Define the “As Is” process map

              • Agree what data is needed to quantify the performance of the process
Measure       • Identify how the data will be collected
              • Collect the data

              • Analyse the performance of the process using the data
 Analyse      • Assess the process using qualitative information
              • Identify the root causes of the performance of the process

              • Identify, select and test possible “To Be” process improvement ideas
 Improve      • Develop plans to implement the selected improvements
              • Implement the new process

              • Assess the performance of the new process
 Control      • Ensure the required performance can be sustained
              • Review the project and apply learning for the future

16                                © 2011 Copyright ISC Ltd.

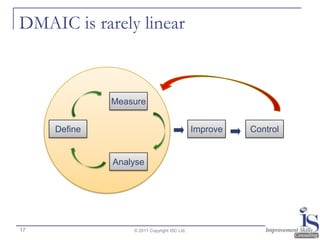

DMAIC is rarely linear

              Measure

     Define                                   Improve   Control

              Analyse

17                © 2011 Copyright ISC Ltd.
Stage 1: Define
    Purpose:                                          Outputs:
      To translate a perceived                          Completed Project Proposal

        problem or opportunity into a                    SIPOC Process Definition
        do-able project                                  Process Map („As Is')
      To ensure the customer‟s
                                                         Analysis of Customer
        needs are identified at the start                 Requirements
        of the project
      To establish a high-level
        understanding of the process

18                                 © 2011 Copyright ISC Ltd.

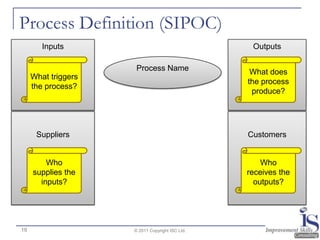

Process Definition (SIPOC)
        Inputs                                    Outputs

                      Process Name                What does
     What triggers
                                                 the process
     the process?
                                                  produce?

      Suppliers                                  Customers

         Who                                         Who
     supplies the                                receives the
       inputs?                                     outputs?

19                   © 2011 Copyright ISC Ltd.

Process Definition (expanded SIPOC)
                  Purpose:________________________________
     Inputs                                                                   Outputs

                                    Process Name

                       Owner:______________________

      Suppliers                       Boundaries                          Customers

                        Start-point:                      End-point:

                        Include:                               Exclude:

20                                 © 2011 Copyright ISC Ltd.
Case study – part 1

21             © 2011 Copyright ISC Ltd.

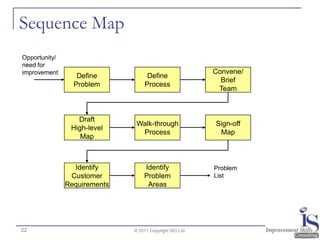

Sequence Map
Opportunity/
need for
improvement                                               Convene/
                  Define            Define
                                                            Brief
                 Problem           Process
                                                           Team

                  Draft
                               Walk-through               Sign-off
                High-level
                                Process                    Map
                   Map

                 Identify         Identify                Problem
                Customer          Problem                 List
               Requirements        Areas

22                            © 2011 Copyright ISC Ltd.

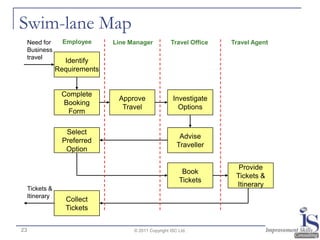

Swim-lane Map
     Need for      Employee     Line Manager           Travel Office   Travel Agent
     Business
     travel
                   Identify
                 Requirements

                  Complete
                                 Approve                Investigate
                  Booking
                                  Travel                  Options
                   Form

                   Select
                                                           Advise
                  Preferred
                                                          Traveller
                   Option

                                                                         Provide
                                                            Book
                                                                        Tickets &
                                                           Tickets
                                                                        Itinerary
     Tickets &
     Itinerary
                   Collect
                   Tickets

23                                    © 2011 Copyright ISC Ltd.

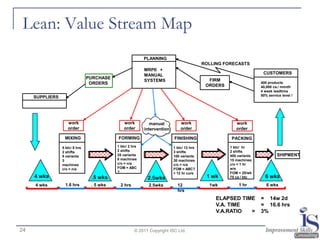

Lean: Value Stream Map
                                                          PLANNING
                                                                                         ROLLING FORECASTS
                                                          MRPII +
                                                          MANUAL                                                   CUSTOMERS
                                PURCHASE                                                   FIRM
                                                          SYSTEMS                                                 400 products
                                 ORDERS                                                   ORDERS                  40,000 ca./ month
                                                                                                                  4 week leadtime
                                                                                                                  50% service level !
     SUPPLIERS

                    work                       work          manual          work                     work
                    order                      order      intervention       order                    order

                  MIXING                   FORMING                       FINISHING                 PACKING

                 5 btc/ 8 hrs              1 btc/ 2 hrs                  1 btc/ 12 hrs             1 btc/ hr
                 2 shifts                  2 shifts                      3 shifts                  2 shifts
                 5 variants                25 variants                   100 variants              400 variants            SHIPMENT
                 3                         8 machines                    30 machines               15 machines
                 machines                  c/o = n/a                     c/o = n/a                 c/o = 1 hr
                 c/o = n/a                 FOM = ABC                     FOM = ABC?                w/e
                                           ?                             + 12 hr cure              FOM = 25/wk
     4 wks                       .5 wks                    2.5wks                         1 wk     75 ca / btc      6 wks
     4 wks        1.6 hrs        . 5 wks     2 hrs          2.5wks         12              1wk         1 hr          6 wks
                                                                           hrs
                                                                                              ELAPSED TIME        = 14w 2d
                                                                                              V.A. TIME           = 16.6 hrs
                                                                                              V.A.RATIO  =        3%

24                                                   © 2011 Copyright ISC Ltd.
Case study – part 2

25             © 2011 Copyright ISC Ltd.
The Voice of the Customer

    Processes exist to meet the requirements of customers (recipients
     of the outputs) and to achieve specific outcomes
    “Customers aren‟t interested in your organisation‟s structure; what
     they see, and feel the effects of, are your processes.”

    Key questions:

        Who are the Customers?
        What do they want?
        What is most important to them?
        How happy are they with what they‟re getting?
        How do they measure your performance?
        What improvements would they like to see?

26                                © 2011 Copyright ISC Ltd.

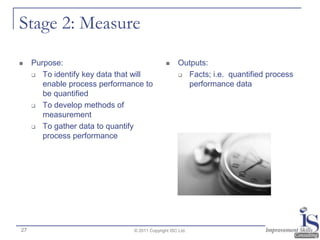

Stage 2: Measure
    Purpose:                                       Outputs:
      To identify key data that will                 Facts; i.e. quantified process

        enable process performance to                  performance data
        be quantified
      To develop methods of
        measurement
      To gather data to quantify

        process performance

27                              © 2011 Copyright ISC Ltd.

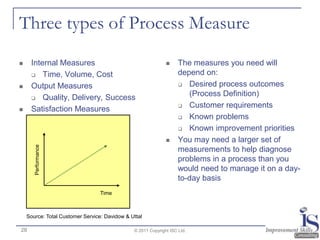

Three types of Process Measure
    Internal Measures                                             The measures you need will
      Time, Volume, Cost                                           depend on:
    Output Measures                                                 Desired process outcomes

      Quality, Delivery, Success
                                                                       (Process Definition)
                                                                     Customer requirements
    Satisfaction Measures
                                                                     Known problems
      Perception
                                                                     Known improvement priorities

                                                                   You may need a larger set of
       Performance

                                                                    measurements to help diagnose
                                                                    problems in a process than you
                                                                    would need to manage it on a day-
                                                                    to-day basis
                                  Time

    Source: Total Customer Service: Davidow & Uttal

28                                             © 2011 Copyright ISC Ltd.

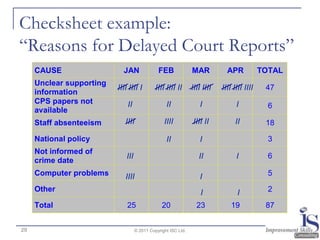

Checksheet example:
“Reasons for Delayed Court Reports”
     CAUSE                  JAN                FEB              MAR           APR            TOTAL
     Unclear supporting
                          IIII IIII I         IIII IIII II      IIII IIII   IIII IIII IIII    47
     information
     CPS papers not           II                   II               I             I            6
     available
     Staff absenteeism       IIII                 IIII           IIII II          II          18

     National policy                               II               I                          3
     Not informed of
                              III                                  II             I            6
     crime date
     Computer problems       IIII                                   I                          5

     Other                                                          I             I            2

     Total                    25                 20               23            19            87

29                                  © 2011 Copyright ISC Ltd.

Concentration Diagram

                  Application Form
     Ref. No.           Auth Code                XXXX
      Dept.       Salary      Grade             Address
         X      XXXXX        X                            This shows fields
                XXXX                                      which have
                                                          missing information,
                                                          incorrect details,
                                                          invalid data etc. and
                                                          quantifies those
                                                          problems.

30                         © 2011 Copyright ISC Ltd.
“Traveller” Time Log example for
     Expenses Claims process
          Process Step           Date/Time arrived   Processing Time   Date/Time sent

          1. Receive & Log
          Form
          2. Validate
          information
          3. Calculate Vat
          amount
          4. Authorise Claim

          5. Set up Bank
          payment
          6. Notify claimant

          7. Update Ledgers

          8. File receipts and
          Form

© 2011 Copyright
    ISC Ltd.                                  31

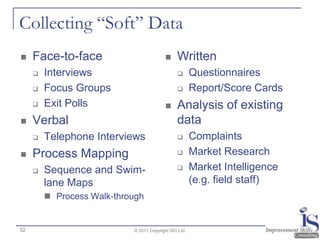

Collecting “Soft” Data
    Face-to-face                              Written
        Interviews                                    Questionnaires
        Focus Groups                                  Report/Score Cards
        Exit Polls                            Analysis of existing
    Verbal                                     data
        Telephone Interviews                          Complaints
    Process Mapping                                   Market Research
        Sequence and Swim-                            Market Intelligence
         lane Maps                                      (e.g. field staff)
          Process Walk-through

32                          © 2011 Copyright ISC Ltd.
Stage 3: Analyse
    Purpose:                                         Outputs:
      To assess and understand                         Identification of waste

        process performance data                        Agreed root causes of process
      To evaluate, qualitatively, the                   performance
        performance of the process
      To identify root causes of

        process performance

33                                © 2011 Copyright ISC Ltd.
Waste
    Waste is anything that does not add value to
     your product or service
        Eliminating waste gives you more resource to
         meet your customers‟ requirements
        Waste will always be present, so there is always
         something that you can do to improve your
         performance
    Identifying all the waste in your processes forces you to
     compare your operation against perfection.....…and this is not a
     comfortable experience!

34                          © 2011 Copyright ISC Ltd.

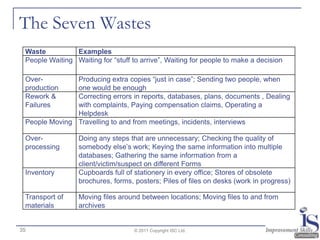

The Seven Wastes
 Waste          Examples
 People Waiting Waiting for “stuff to arrive”, Waiting for people to make a decision

 Over-         Producing extra copies “just in case”; Sending two people, when
 production    one would be enough
 Rework &      Correcting errors in reports, databases, plans, documents , Dealing
 Failures      with complaints, Paying compensation claims, Operating a
               Helpdesk
 People Moving Travelling to and from meetings, incidents, interviews

 Over-            Doing any steps that are unnecessary; Checking the quality of
 processing       somebody else‟s work; Keying the same information into multiple
                  databases; Gathering the same information from a
                  client/victim/suspect on different Forms
 Inventory        Cupboards full of stationery in every office; Stores of obsolete
                  brochures, forms, posters; Piles of files on desks (work in progress)

 Transport of     Moving files around between locations; Moving files to and from
 materials        archives

35                                  © 2011 Copyright ISC Ltd.
Value Add
         • Every activity in a process either adds value or cost.
         • Value Add is determined firstly from the Customer‟s perspective.
         • There may also be Business Value Adding activities.
         • Everything else is Waste.

        Real Value Add                                  Business Value Add
          Those activities which a                        Those activities which you

           customer would expect you                        have to do in order to…
           to do for them in producing                           Stay legal
           the output                                            Be compliant
          Ask “Could we invoice the                             Manage the organisation
           customer for having done this                       Challenge: “Would we get
           activity?”                                           locked up, shut down, or
                                                                fined, if we didn‟t do this
                                                                activity?

    36                              © 2011 Copyright ISC Ltd.
x

 37
                                                        10
                                                             20
                                                                  30
                                                                       40
                                                                            50
                                                                                 60
                                                                                      70
                                                                                                       80

                                                    0
                                          Apr-05
                                            May
                                             Jun
                                              Jul
                                            Aug
                                            Sep
                                             Oct
                                            Nov
                                            Dec
                                             Jan                                       New Procedure
                                            Feb
                                            Mar
                                          Apr-06
                                            May
                                             Jun
                                              Jul
                                            Aug
                                            Sep
                                             Oct
                                            Nov
                                            Dec

                            UCL
                                             Jan
                                            Feb
                                            Mar
                                          Apr-07

                            LCL
                                            May
                                                                                                                               Data Handling Tools

                                             Jun
                                              Jul
                                            Aug
                                                                                                            Monthly Caseload

© 2011 Copyright ISC Ltd.
                                            Sep
                                             Oct
                                            Nov
                            Process Avg     Dec
                                             Jan
                                            Feb
                                            Mar
                                          Apr-08
                                            May
                                             Jun
                                              Jul
                                            Aug
                                            Sep
                                             Oct
                                            Nov
Pareto Analysis
    The Pareto Principle suggests that a small number of
     causes (the vital few) will typically account for a large
     proportion of effects. The remaining causes (the trivial
     many) only account for a small part of the problem.
                          20%

     This is also known
     as the 80:20 rule
                          80%                           80%

                                                        20%
                           Effects                      Causes

38                          © 2011 Copyright ISC Ltd.

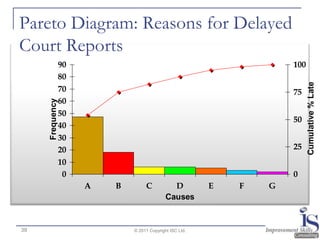

Pareto Diagram: Reasons for Delayed
Court Reports
                 90                                                   100
                 80

                                                                            Cumulative % Late
                 70                                                   75
                 60
     Frequency

                 50
                                                                      50
                 40
                 30
                 20                                                   25
                 10
                  0                                                   0
                      A   B        C           D          E   F   G
                                             Causes

39                            © 2011 Copyright ISC Ltd.

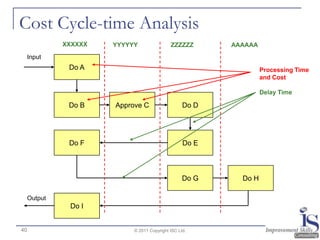

Cost Cycle-time Analysis
              XXXXXX   YYYYYY                ZZZZZZ       AAAAAA
     Input
               Do A                                                Processing Time
                                                                   and Cost

                                                                   Delay Time

               Do B    Approve C                   Do D

               Do F                                Do E

                                                   Do G     Do H

     Output
               Do I

40                          © 2011 Copyright ISC Ltd.

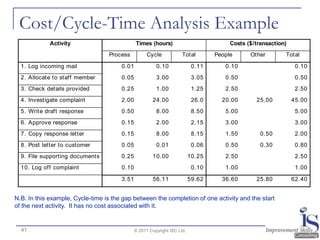

Cost/Cycle-Time Analysis Example
             Activity                         Times (hours)                            Costs ($/transaction)
                                  Process           Cycle            Total        People      Other        Total

  1. Log incoming mail                 0.01             0.10               0.11      0.10                       0.10
  2. Allocate to staff member          0.05             3.00               3.05      0.50                       0.50
  3. Check details provided            0.25             1.00               1.25      2.50                       2.50
  4. Investigate complaint             2.00           24.00                26.0     20.00       25.00          45.00
  5. Write draft response              0.50             8.00               8.50      5.00                       5.00
  6. Approve response                  0.15             2.00               2.15      3.00                       3.00
  7. Copy response letter              0.15             8.00               8.15      1.50         0.50          2.00
  8. Post letter to customer           0.05             0.01               0.06      0.50         0.30          0.80
  9. File supporting documents         0.25           10.00               10.25      2.50                       2.50
  10. Log off complaint                0.10                                0.10      1.00                       1.00

                                       3.51           56.11               59.62     36.60       25.80          62.40

N.B. In this example, Cycle-time is the gap between the completion of one activity and the start
of the next activity. It has no cost associated with it.

  41                                          © 2011 Copyright ISC Ltd.
Case study – part 3

42             © 2011 Copyright ISC Ltd.

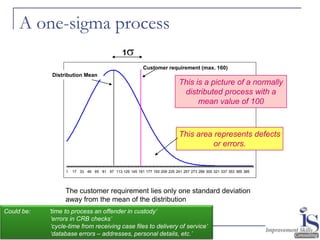

A one-sigma process
                                               1
                                                         Customer requirement (max. 160)
             Distribution Mean
                                                                           This is a picture of a normally
                                                                            distributed process with a
                                                                                 mean value of 100

                                                                           This area represents defects
                                                                                     or errors.

                  1   17 33 49 65 81 97 113 129 145 161 177 193 209 225 241 257 273 289 305 321 337 353 369 385

                  The customer requirement lies only one standard deviation
                  away from the mean of the distribution
Could be:   „time to process an offender in custody‟
             „errors in CRB checks‟
             „cycle-time from receiving case files to delivery of service‟
     43                                     © 2011 Copyright ISC Ltd.
             „database errors – addresses, personal details, etc.‟

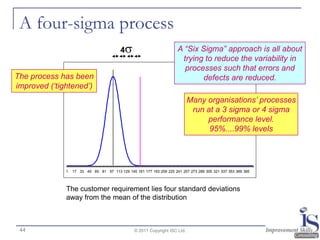

A four-sigma process
                                          4                           A “Six Sigma” approach is all about
                                                                       trying to reduce the variability in
                                                                        processes such that errors and
The process has been                                                         defects are reduced.
improved („tightened‟)
                                                                             Many organisations‟ processes
                                                                              run at a 3 sigma or 4 sigma
                                                                                  performance level.
                                                                                   95%....99% levels

              1   17 33 49 65 81 97 113 129 145 161 177 193 209 225 241 257 273 289 305 321 337 353 369 385

              The customer requirement lies four standard deviations
              away from the mean of the distribution

 44                                              © 2011 Copyright ISC Ltd.

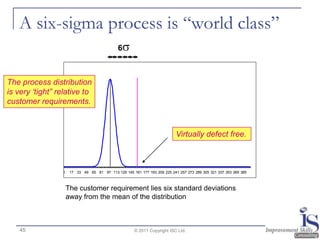

A six-sigma process is “world class”
                                              6

The process distribution
is very „tight” relative to
customer requirements.

                                                                           Virtually defect free.

                 1    17 33 49 65 81 97 113 129 145 161 177 193 209 225 241 257 273 289 305 321 337 353 369 385

                     The customer requirement lies six standard deviations
                     away from the mean of the distribution

    45                                                © 2011 Copyright ISC Ltd.

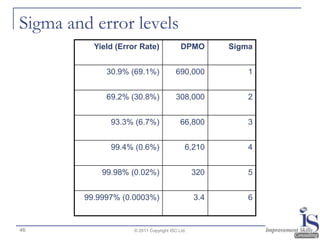

Sigma and error levels
          Yield (Error Rate)               DPMO        Sigma

             30.9% (69.1%)               690,000           1

             69.2% (30.8%)               308,000           2

              93.3% (6.7%)                 66,800          3

              99.4% (0.6%)                   6,210         4

            99.98% (0.02%)                       320       5

        99.9997% (0.0003%)                       3.4       6

46                   © 2011 Copyright ISC Ltd.
Stage 4: Improve
    Purpose:                                       Outputs:
      To identify, select and test                   An improved process, in place

        potential improvements to                      and operating
        meet the project and customer
        requirements
      To plan implementation of
        improvements
      To implement an improved
        process design

47                              © 2011 Copyright ISC Ltd.
The Principles of a Good Process
   Good processes are based on the idea that you only do
    what you need to do to meet the customer‟s requirement
   Any activity should start and finish as late as possible
        This increases the relevance of what is done, reduces cycle times,
         etc, but makes the system very reliant on getting things right first time
   Throughput time for any individual item (piece of paper,
    information or item) processed is very short
        i.e. if we clock any individual or document through a process, it takes
         the minimum possible time to go through all the stages
   There a minimum of work in progress, and therefore little
    queuing between stages (this means no paper on desks, no
    big queues in e-mail Inboxes, or queues of items at any
    stage)
        The different stages are designed to be balanced in their work input
         and output
    48                             © 2011 Copyright ISC Ltd.

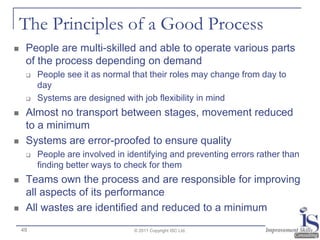

The Principles of a Good Process
    People are multi-skilled and able to operate various parts
     of the process depending on demand
        People see it as normal that their roles may change from day to
         day
        Systems are designed with job flexibility in mind
    Almost no transport between stages, movement reduced
     to a minimum
    Systems are error-proofed to ensure quality
        People are involved in identifying and preventing errors rather than
         finding better ways to check for them
    Teams own the process and are responsible for improving
     all aspects of its performance
    All wastes are identified and reduced to a minimum
    49                            © 2011 Copyright ISC Ltd.

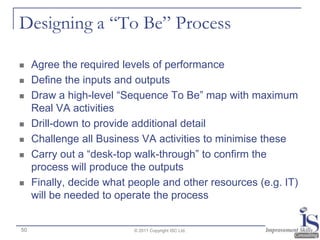

Designing a “To Be” Process

    Agree the required levels of performance
    Define the inputs and outputs
    Draw a high-level “Sequence To Be” map with maximum
     Real VA activities
    Drill-down to provide additional detail
    Challenge all Business VA activities to minimise these
    Carry out a “desk-top walk-through” to confirm the
     process will produce the outputs
    Finally, decide what people and other resources (e.g. IT)
     will be needed to operate the process

50                         © 2011 Copyright ISC Ltd.

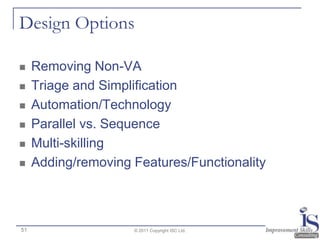

Design Options

    Removing Non-VA
    Triage and Simplification
    Automation/Technology
    Parallel vs. Sequence
    Multi-skilling
    Adding/removing Features/Functionality

51                   © 2011 Copyright ISC Ltd.
Case study – part 4

52             © 2011 Copyright ISC Ltd.

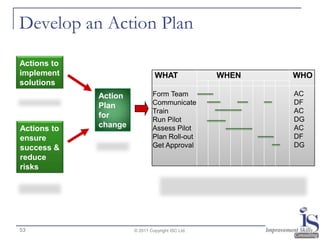

Develop an Action Plan

Actions to
implement                      WHAT               WHEN   WHO
solutions
             Action           Form Team                  AC
             Plan             Communicate                DF
                              Train                      AC
             for                                         DG
                              Run Pilot
Actions to   change           Assess Pilot               AC
ensure                        Plan Roll-out              DF
success &                     Get Approval               DG
reduce
risks

53                    © 2011 Copyright ISC Ltd.
Stage 5: Control
    Purpose:                                       Outputs:
      To ensure the performance of                   Project Completion Report

        the re-designed process can                   Updated Process Definition
        be sustained and continuously                  Template
        improved                                      Process Measurement Plan

54                              © 2011 Copyright ISC Ltd.
Appoint a Process Owner

    A single, named individual who is responsible for managing and
     improving the performance of the process to meet customer needs
     and achieve business outcomes

    In the Control phase this will involve...
        Ensuring measurement systems are in place to quantify and report
         performance
        Regularly reviewing the process in light of customer and business
         needs, and identifying further improvements needed (maybe including
         external Benchmarking)
        Addressing areas of under-performance and ensuring corrective actions
         are taken
        Maintaining the skills and capabilities of those who have to manage,
         operate and improve the process

55                               © 2011 Copyright ISC Ltd.
Control Charts
             Control charts allow us to see if what is
             happening to a process is outside what we
             would normally expect to see.

                                                         Upper Control
                                                         Limit

                                                         Lower Control
                                                         Limit

56               © 2011 Copyright ISC Ltd.
Continuous Improvement

                                                                     Benchmark
 Celebrate                                                           vs. Leaders
 Success
                                        Set
                                   Performance
                                     Targets

     Review Performance                                               Identify
         vs. Targets                                               Improvements

                     Measure Process                   Implement
                      Performance                       Changes

57                             © 2011 Copyright ISC Ltd.
Project Completion Report

    What did you set out to achieve?
    What did you achieve?
    How did you achieve it?
        What worked well?
        What didn‟t?
    What learning can be transferred elsewhere?
    Have you celebrated your success?

58                       © 2011 Copyright ISC Ltd.

Ensuring Success: Force Field Analysis
        What are all the things that will help us               What are all the things that might hinder
         implement successfully?                                  successful implementation?

         Include actions in your Plan to build on                 Include actions in your Plan to minimise,
         these                                                    or eliminate, these

    59                                      © 2011 Copyright ISC Ltd.
Ian J Seath, Director
     Improvement Skills Consulting Ltd.

          www.improvement-skills.co.uk
          ian.seath@improvement-skills.co.uk
          M: 07850 728506
                  @ianjseath

60                  © 2011 Copyright ISC Ltd.

OR Society workshop: Practical process improvement using Lean and 6 Sigma

  • 1.
    Practical Process Improvement using Lean and Six Sigma A 1-day workshop for the OR Society Facilitated by Ian J Seath 1 © 2011 Copyright ISC Ltd.
  • 2.
    What you willlearn…  How Lean and 6-Sigma differ, yet are complementary approaches for process improvement  How to set-up and define a process improvement project  How to use appropriate tools to map, measure and analyse business processes  How to design a Lean, value-adding process  How to engage key stakeholders and staff to ensure effective management of process change An introduction to the tools and techniques for defining, measuring, analysing and improving business processes using methods from the Lean and 6-Sigma toolkits. 2 © 2011 Copyright ISC Ltd.
  • 3.
    Is that an“active banana” or an “inactive banana” on your desk? 3 © 2011 Copyright ISC Ltd.
  • 4.
    What is aProcess?  Processes take INPUTS, do WORK to them, and produce OUTPUTS for CUSTOMERS Input Process Output  They exist to achieve performance OUTCOMES (for the benefit of customers or stakeholders) 4 © 2011 Copyright ISC Ltd.
  • 5.
    Focus of improvement Cheaper Happier Customers Efficient Effective Less Waste Better More More Reliable Responsive Flexible Capable & Agile Faster More Capacity 5 © 2011 Copyright ISC Ltd.
  • 6.
    In two sentences…  Lean:  Driving out waste by using TIME as a competitive weapon  Six Sigma:  Driving out waste by reducing VARIATION 6 © 2011 Copyright ISC Ltd.
  • 7.
    Who’s using Leanand Six Sigma? Recent examples of ‘service’ or ‘back office’ programmes have delivered significant benefits including: Probation Centrica Drug Testing Utility Call Centre Programme Home Office Capacity increased to Considerable real benefits in call handling Claim process capacity 110% of target increased by 130% O2 ING Value Stream Programme Foreign Exchange Bolton Hospital Processing 25% reduction in time spent on non-value- Pathology Lab Increased straight- adding activity in store through processing from Sample testing time 70% to 95% reduced from 24 to 2 hours 7 © 2011 Copyright ISC Ltd.
  • 8.
    Evolution of LeanThinking 1991 Lean Thinking “Lean Enterprise” Lean Concepts Toyota Production System 8 © 2011 Copyright ISC Ltd.
  • 9.
    Lean: Time asa competitive advantage ALLOCATION & CUSTOMERS PLANNING WRITTEN ACK ENQUIRIES RECEIVED MEMO SIGN SIGN SIGN OFF OFF OFF SORTING ANALYSIS RESPONSE AGREEMENT ACTION 4 hrs 24 hrs 8hrs 16 hrs 1.5 hrs 4 hrs 4 hrs 24 hrs 1 hr 8 hrs .5 hr 16 hrs ELAPSED TIME = 59 hrs V.A. TIME = 7 hrs V.A.RATIO = 4% 9 © 2011 Copyright ISC Ltd. 20M_16
  • 10.
    Evolution of SixSigma Encompassing Existing Support Techniques Problem Structure Solving Statistical Toolkit People Process Project Measurement Skills Control Zero Based Defects Black (DMAIC) 1980s Belt Approach 2000 2011 Statistics Holistic 10 © 2011 Copyright ISC Ltd.
  • 11.
    Six Sigma providesa common basis for comparison  Which of these processes is performing best?  Accounts receivable  35 days sales outstanding (DSO)  Call answering  10 rings on average  Customer service  89% satisfied, or very satisfied  Invoicing  99% accuracy  Checkout queue  3 minutes on average 11 © 2011 Copyright ISC Ltd.
  • 12.
    6 Sigma: Customersfeel the Variance, not the Mean On average Supplier our rope is 2 cm thick ! That‟s good Customer to know! 12 © 2011 Copyright ISC Ltd.
  • 13.
    Lean and SixSigma Lean Six Sigma  Evolved from the Toyota  “TQM on steroids” Production System  A statistically-based approach  Focus on identifying and to process improvement delivering customer value  Requires support from “Black  Managing horizontal value Belts” for implementation streams (& systems thinking)  Achieves improvement through  Aligning capacity to demand project activity, chosen by and creating “flow” management; often based on  Engaging front-line staff in ROI potential daily improvement  An evolution from “Zero  Using visual management to Defects” thinking of the 1990s track performance  Aiming for fewer than 3.4 ppm  Managers “go and see” defects 13 © 2011 Copyright ISC Ltd.
  • 14.
    Tools/Techniques Six Sigma Lean  SIPOC  The Seven Wastes  Voice of the Customer  5S  House of Quality (QFD)  Poka Yoke  Process Mapping  Value Stream Mapping  Design of Experiments  Kaizen  Statistical Process Control  Standardised Work  Taguchi  Visual Management  Sampling & Data Collection  Flow: Push & Pull  Statistical Analysis  Just-in-time  Failure Modes Effect Analysis  Takt time  DPMO/Sigma/CPK  Value Add Ratio 14 © 2011 Copyright ISC Ltd.
  • 15.
    Improvement approach Six Sigma: Define Measure Analyse Improve Control Understand Reduce Implement Improve Where are we now? current waste improvement continuously performance Lean: Current State VSM VAR Waste/Flow Future State VSM 15 © 2011 Copyright ISC Ltd.
  • 16.
    Process Improvement (DMAIC) • Agree the problem/opportunity for the Process Improvement Project Define • Identify the process customers and what they want • Define the “As Is” process map • Agree what data is needed to quantify the performance of the process Measure • Identify how the data will be collected • Collect the data • Analyse the performance of the process using the data Analyse • Assess the process using qualitative information • Identify the root causes of the performance of the process • Identify, select and test possible “To Be” process improvement ideas Improve • Develop plans to implement the selected improvements • Implement the new process • Assess the performance of the new process Control • Ensure the required performance can be sustained • Review the project and apply learning for the future 16 © 2011 Copyright ISC Ltd.
  • 17.
    DMAIC is rarelylinear Measure Define Improve Control Analyse 17 © 2011 Copyright ISC Ltd.
  • 18.
    Stage 1: Define  Purpose:  Outputs:  To translate a perceived  Completed Project Proposal problem or opportunity into a  SIPOC Process Definition do-able project  Process Map („As Is')  To ensure the customer‟s  Analysis of Customer needs are identified at the start Requirements of the project  To establish a high-level understanding of the process 18 © 2011 Copyright ISC Ltd.
  • 19.
    Process Definition (SIPOC) Inputs Outputs Process Name What does What triggers the process the process? produce? Suppliers Customers Who Who supplies the receives the inputs? outputs? 19 © 2011 Copyright ISC Ltd.
  • 20.
    Process Definition (expandedSIPOC) Purpose:________________________________ Inputs Outputs Process Name Owner:______________________ Suppliers Boundaries Customers Start-point: End-point: Include: Exclude: 20 © 2011 Copyright ISC Ltd.
  • 21.
    Case study –part 1 21 © 2011 Copyright ISC Ltd.
  • 22.
    Sequence Map Opportunity/ need for improvement Convene/ Define Define Brief Problem Process Team Draft Walk-through Sign-off High-level Process Map Map Identify Identify Problem Customer Problem List Requirements Areas 22 © 2011 Copyright ISC Ltd.
  • 23.
    Swim-lane Map Need for Employee Line Manager Travel Office Travel Agent Business travel Identify Requirements Complete Approve Investigate Booking Travel Options Form Select Advise Preferred Traveller Option Provide Book Tickets & Tickets Itinerary Tickets & Itinerary Collect Tickets 23 © 2011 Copyright ISC Ltd.
  • 24.
    Lean: Value StreamMap PLANNING ROLLING FORECASTS MRPII + MANUAL CUSTOMERS PURCHASE FIRM SYSTEMS 400 products ORDERS ORDERS 40,000 ca./ month 4 week leadtime 50% service level ! SUPPLIERS work work manual work work order order intervention order order MIXING FORMING FINISHING PACKING 5 btc/ 8 hrs 1 btc/ 2 hrs 1 btc/ 12 hrs 1 btc/ hr 2 shifts 2 shifts 3 shifts 2 shifts 5 variants 25 variants 100 variants 400 variants SHIPMENT 3 8 machines 30 machines 15 machines machines c/o = n/a c/o = n/a c/o = 1 hr c/o = n/a FOM = ABC FOM = ABC? w/e ? + 12 hr cure FOM = 25/wk 4 wks .5 wks 2.5wks 1 wk 75 ca / btc 6 wks 4 wks 1.6 hrs . 5 wks 2 hrs 2.5wks 12 1wk 1 hr 6 wks hrs ELAPSED TIME = 14w 2d V.A. TIME = 16.6 hrs V.A.RATIO = 3% 24 © 2011 Copyright ISC Ltd.
  • 25.
    Case study –part 2 25 © 2011 Copyright ISC Ltd.
  • 26.
    The Voice ofthe Customer  Processes exist to meet the requirements of customers (recipients of the outputs) and to achieve specific outcomes  “Customers aren‟t interested in your organisation‟s structure; what they see, and feel the effects of, are your processes.”  Key questions:  Who are the Customers?  What do they want?  What is most important to them?  How happy are they with what they‟re getting?  How do they measure your performance?  What improvements would they like to see? 26 © 2011 Copyright ISC Ltd.
  • 27.
    Stage 2: Measure  Purpose:  Outputs:  To identify key data that will  Facts; i.e. quantified process enable process performance to performance data be quantified  To develop methods of measurement  To gather data to quantify process performance 27 © 2011 Copyright ISC Ltd.
  • 28.
    Three types ofProcess Measure  Internal Measures  The measures you need will  Time, Volume, Cost depend on:  Output Measures  Desired process outcomes  Quality, Delivery, Success (Process Definition)  Customer requirements  Satisfaction Measures  Known problems  Perception  Known improvement priorities  You may need a larger set of Performance measurements to help diagnose problems in a process than you would need to manage it on a day- to-day basis Time Source: Total Customer Service: Davidow & Uttal 28 © 2011 Copyright ISC Ltd.
  • 29.
    Checksheet example: “Reasons forDelayed Court Reports” CAUSE JAN FEB MAR APR TOTAL Unclear supporting IIII IIII I IIII IIII II IIII IIII IIII IIII IIII 47 information CPS papers not II II I I 6 available Staff absenteeism IIII IIII IIII II II 18 National policy II I 3 Not informed of III II I 6 crime date Computer problems IIII I 5 Other I I 2 Total 25 20 23 19 87 29 © 2011 Copyright ISC Ltd.
  • 30.
    Concentration Diagram Application Form Ref. No. Auth Code XXXX Dept. Salary Grade Address X XXXXX X This shows fields XXXX which have missing information, incorrect details, invalid data etc. and quantifies those problems. 30 © 2011 Copyright ISC Ltd.
  • 31.
    “Traveller” Time Logexample for Expenses Claims process Process Step Date/Time arrived Processing Time Date/Time sent 1. Receive & Log Form 2. Validate information 3. Calculate Vat amount 4. Authorise Claim 5. Set up Bank payment 6. Notify claimant 7. Update Ledgers 8. File receipts and Form © 2011 Copyright ISC Ltd. 31
  • 32.
    Collecting “Soft” Data  Face-to-face  Written  Interviews  Questionnaires  Focus Groups  Report/Score Cards  Exit Polls  Analysis of existing  Verbal data  Telephone Interviews  Complaints  Process Mapping  Market Research  Sequence and Swim-  Market Intelligence lane Maps (e.g. field staff)  Process Walk-through 32 © 2011 Copyright ISC Ltd.
  • 33.
    Stage 3: Analyse  Purpose:  Outputs:  To assess and understand  Identification of waste process performance data  Agreed root causes of process  To evaluate, qualitatively, the performance performance of the process  To identify root causes of process performance 33 © 2011 Copyright ISC Ltd.
  • 34.
    Waste  Waste is anything that does not add value to your product or service  Eliminating waste gives you more resource to meet your customers‟ requirements  Waste will always be present, so there is always something that you can do to improve your performance  Identifying all the waste in your processes forces you to compare your operation against perfection.....…and this is not a comfortable experience! 34 © 2011 Copyright ISC Ltd.
  • 35.
    The Seven Wastes Waste Examples People Waiting Waiting for “stuff to arrive”, Waiting for people to make a decision Over- Producing extra copies “just in case”; Sending two people, when production one would be enough Rework & Correcting errors in reports, databases, plans, documents , Dealing Failures with complaints, Paying compensation claims, Operating a Helpdesk People Moving Travelling to and from meetings, incidents, interviews Over- Doing any steps that are unnecessary; Checking the quality of processing somebody else‟s work; Keying the same information into multiple databases; Gathering the same information from a client/victim/suspect on different Forms Inventory Cupboards full of stationery in every office; Stores of obsolete brochures, forms, posters; Piles of files on desks (work in progress) Transport of Moving files around between locations; Moving files to and from materials archives 35 © 2011 Copyright ISC Ltd.
  • 36.
    Value Add • Every activity in a process either adds value or cost. • Value Add is determined firstly from the Customer‟s perspective. • There may also be Business Value Adding activities. • Everything else is Waste.  Real Value Add  Business Value Add  Those activities which a  Those activities which you customer would expect you have to do in order to… to do for them in producing  Stay legal the output  Be compliant  Ask “Could we invoice the  Manage the organisation customer for having done this  Challenge: “Would we get activity?” locked up, shut down, or fined, if we didn‟t do this activity? 36 © 2011 Copyright ISC Ltd.
  • 37.
    x 37 10 20 30 40 50 60 70 80 0 Apr-05 May Jun Jul Aug Sep Oct Nov Dec Jan New Procedure Feb Mar Apr-06 May Jun Jul Aug Sep Oct Nov Dec UCL Jan Feb Mar Apr-07 LCL May Data Handling Tools Jun Jul Aug Monthly Caseload © 2011 Copyright ISC Ltd. Sep Oct Nov Process Avg Dec Jan Feb Mar Apr-08 May Jun Jul Aug Sep Oct Nov
  • 38.
    Pareto Analysis  The Pareto Principle suggests that a small number of causes (the vital few) will typically account for a large proportion of effects. The remaining causes (the trivial many) only account for a small part of the problem. 20% This is also known as the 80:20 rule 80% 80% 20% Effects Causes 38 © 2011 Copyright ISC Ltd.
  • 39.
    Pareto Diagram: Reasonsfor Delayed Court Reports 90 100 80 Cumulative % Late 70 75 60 Frequency 50 50 40 30 20 25 10 0 0 A B C D E F G Causes 39 © 2011 Copyright ISC Ltd.
  • 40.
    Cost Cycle-time Analysis XXXXXX YYYYYY ZZZZZZ AAAAAA Input Do A Processing Time and Cost Delay Time Do B Approve C Do D Do F Do E Do G Do H Output Do I 40 © 2011 Copyright ISC Ltd.
  • 41.
    Cost/Cycle-Time Analysis Example Activity Times (hours) Costs ($/transaction) Process Cycle Total People Other Total 1. Log incoming mail 0.01 0.10 0.11 0.10 0.10 2. Allocate to staff member 0.05 3.00 3.05 0.50 0.50 3. Check details provided 0.25 1.00 1.25 2.50 2.50 4. Investigate complaint 2.00 24.00 26.0 20.00 25.00 45.00 5. Write draft response 0.50 8.00 8.50 5.00 5.00 6. Approve response 0.15 2.00 2.15 3.00 3.00 7. Copy response letter 0.15 8.00 8.15 1.50 0.50 2.00 8. Post letter to customer 0.05 0.01 0.06 0.50 0.30 0.80 9. File supporting documents 0.25 10.00 10.25 2.50 2.50 10. Log off complaint 0.10 0.10 1.00 1.00 3.51 56.11 59.62 36.60 25.80 62.40 N.B. In this example, Cycle-time is the gap between the completion of one activity and the start of the next activity. It has no cost associated with it. 41 © 2011 Copyright ISC Ltd.
  • 42.
    Case study –part 3 42 © 2011 Copyright ISC Ltd.
  • 43.
    A one-sigma process 1 Customer requirement (max. 160) Distribution Mean This is a picture of a normally distributed process with a mean value of 100 This area represents defects or errors. 1 17 33 49 65 81 97 113 129 145 161 177 193 209 225 241 257 273 289 305 321 337 353 369 385 The customer requirement lies only one standard deviation away from the mean of the distribution Could be: „time to process an offender in custody‟ „errors in CRB checks‟ „cycle-time from receiving case files to delivery of service‟ 43 © 2011 Copyright ISC Ltd. „database errors – addresses, personal details, etc.‟
  • 44.
    A four-sigma process 4 A “Six Sigma” approach is all about trying to reduce the variability in processes such that errors and The process has been defects are reduced. improved („tightened‟) Many organisations‟ processes run at a 3 sigma or 4 sigma performance level. 95%....99% levels 1 17 33 49 65 81 97 113 129 145 161 177 193 209 225 241 257 273 289 305 321 337 353 369 385 The customer requirement lies four standard deviations away from the mean of the distribution 44 © 2011 Copyright ISC Ltd.
  • 45.
    A six-sigma processis “world class” 6 The process distribution is very „tight” relative to customer requirements. Virtually defect free. 1 17 33 49 65 81 97 113 129 145 161 177 193 209 225 241 257 273 289 305 321 337 353 369 385 The customer requirement lies six standard deviations away from the mean of the distribution 45 © 2011 Copyright ISC Ltd.
  • 46.
    Sigma and errorlevels Yield (Error Rate) DPMO Sigma 30.9% (69.1%) 690,000 1 69.2% (30.8%) 308,000 2 93.3% (6.7%) 66,800 3 99.4% (0.6%) 6,210 4 99.98% (0.02%) 320 5 99.9997% (0.0003%) 3.4 6 46 © 2011 Copyright ISC Ltd.
  • 47.
    Stage 4: Improve  Purpose:  Outputs:  To identify, select and test  An improved process, in place potential improvements to and operating meet the project and customer requirements  To plan implementation of improvements  To implement an improved process design 47 © 2011 Copyright ISC Ltd.
  • 48.
    The Principles ofa Good Process  Good processes are based on the idea that you only do what you need to do to meet the customer‟s requirement  Any activity should start and finish as late as possible  This increases the relevance of what is done, reduces cycle times, etc, but makes the system very reliant on getting things right first time  Throughput time for any individual item (piece of paper, information or item) processed is very short  i.e. if we clock any individual or document through a process, it takes the minimum possible time to go through all the stages  There a minimum of work in progress, and therefore little queuing between stages (this means no paper on desks, no big queues in e-mail Inboxes, or queues of items at any stage)  The different stages are designed to be balanced in their work input and output 48 © 2011 Copyright ISC Ltd.
  • 49.
    The Principles ofa Good Process  People are multi-skilled and able to operate various parts of the process depending on demand  People see it as normal that their roles may change from day to day  Systems are designed with job flexibility in mind  Almost no transport between stages, movement reduced to a minimum  Systems are error-proofed to ensure quality  People are involved in identifying and preventing errors rather than finding better ways to check for them  Teams own the process and are responsible for improving all aspects of its performance  All wastes are identified and reduced to a minimum 49 © 2011 Copyright ISC Ltd.
  • 50.
    Designing a “ToBe” Process  Agree the required levels of performance  Define the inputs and outputs  Draw a high-level “Sequence To Be” map with maximum Real VA activities  Drill-down to provide additional detail  Challenge all Business VA activities to minimise these  Carry out a “desk-top walk-through” to confirm the process will produce the outputs  Finally, decide what people and other resources (e.g. IT) will be needed to operate the process 50 © 2011 Copyright ISC Ltd.
  • 51.
    Design Options  Removing Non-VA  Triage and Simplification  Automation/Technology  Parallel vs. Sequence  Multi-skilling  Adding/removing Features/Functionality 51 © 2011 Copyright ISC Ltd.
  • 52.
    Case study –part 4 52 © 2011 Copyright ISC Ltd.
  • 53.
    Develop an ActionPlan Actions to implement WHAT WHEN WHO solutions Action Form Team AC Plan Communicate DF Train AC for DG Run Pilot Actions to change Assess Pilot AC ensure Plan Roll-out DF success & Get Approval DG reduce risks 53 © 2011 Copyright ISC Ltd.
  • 54.
    Stage 5: Control  Purpose:  Outputs:  To ensure the performance of  Project Completion Report the re-designed process can  Updated Process Definition be sustained and continuously Template improved  Process Measurement Plan 54 © 2011 Copyright ISC Ltd.
  • 55.
    Appoint a ProcessOwner  A single, named individual who is responsible for managing and improving the performance of the process to meet customer needs and achieve business outcomes  In the Control phase this will involve...  Ensuring measurement systems are in place to quantify and report performance  Regularly reviewing the process in light of customer and business needs, and identifying further improvements needed (maybe including external Benchmarking)  Addressing areas of under-performance and ensuring corrective actions are taken  Maintaining the skills and capabilities of those who have to manage, operate and improve the process 55 © 2011 Copyright ISC Ltd.
  • 56.
    Control Charts Control charts allow us to see if what is happening to a process is outside what we would normally expect to see. Upper Control Limit Lower Control Limit 56 © 2011 Copyright ISC Ltd.
  • 57.
    Continuous Improvement Benchmark Celebrate vs. Leaders Success Set Performance Targets Review Performance Identify vs. Targets Improvements Measure Process Implement Performance Changes 57 © 2011 Copyright ISC Ltd.
  • 58.
    Project Completion Report  What did you set out to achieve?  What did you achieve?  How did you achieve it?  What worked well?  What didn‟t?  What learning can be transferred elsewhere?  Have you celebrated your success? 58 © 2011 Copyright ISC Ltd.
  • 59.
    Ensuring Success: ForceField Analysis  What are all the things that will help us  What are all the things that might hinder implement successfully? successful implementation? Include actions in your Plan to build on Include actions in your Plan to minimise, these or eliminate, these 59 © 2011 Copyright ISC Ltd.
  • 60.
    Ian J Seath,Director Improvement Skills Consulting Ltd. www.improvement-skills.co.uk ian.seath@improvement-skills.co.uk M: 07850 728506 @ianjseath 60 © 2011 Copyright ISC Ltd.
