National Overall
Reference Architecture
(NORA)
e-Government
Program (Yesser)
2
National Overall Reference Architecture (NORA) – Handbook
Tableof
Contents
3
National Overall Reference Architecture (NORA) – Handbook
Table of Contents

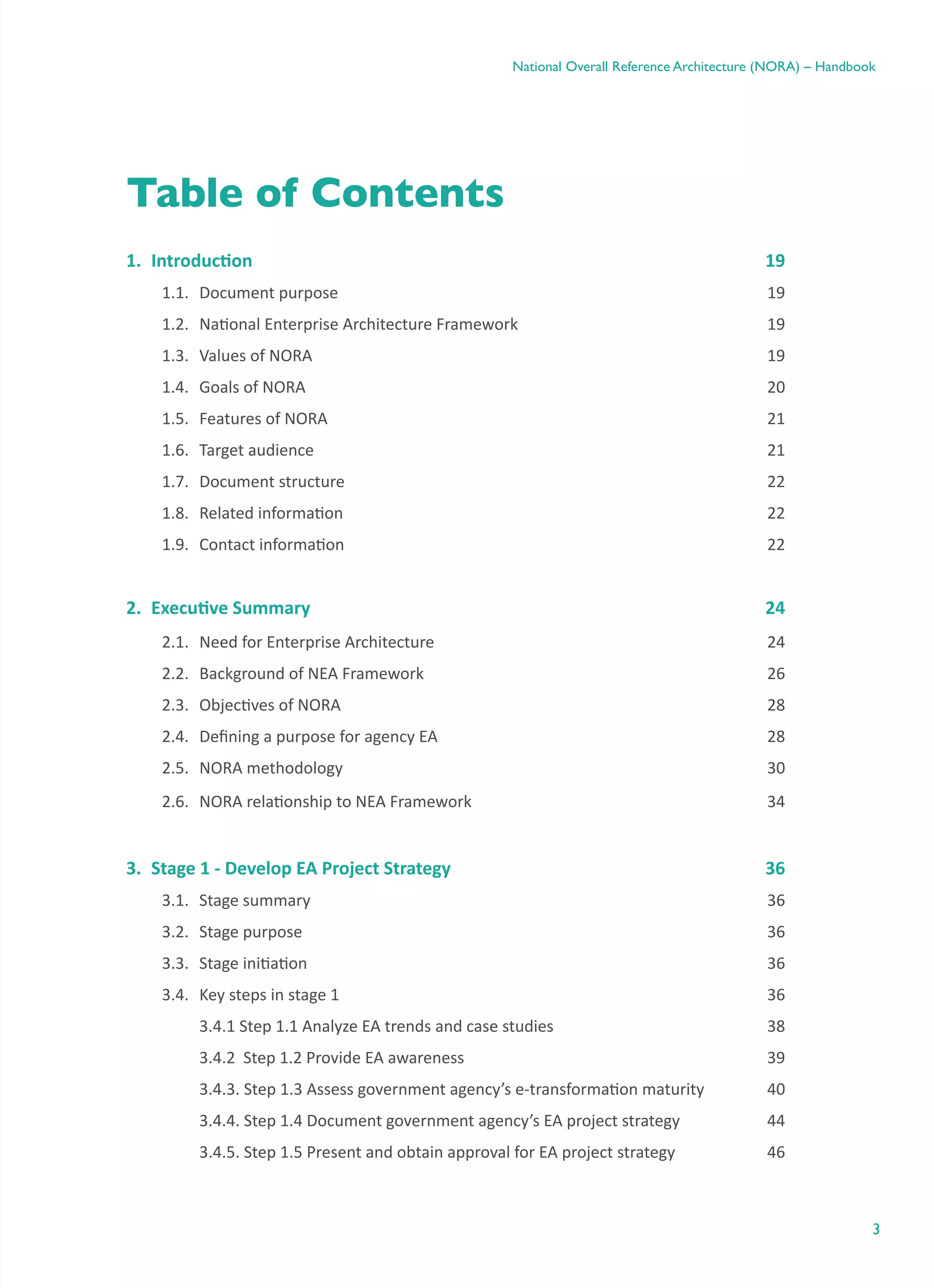

1.	 Introduction	 19
1.1.	 Document purpose	 19
1.2.	 National Enterprise Architecture Framework	 19
1.3.	 Values of NORA	 19
1.4.	 Goals of NORA	 20

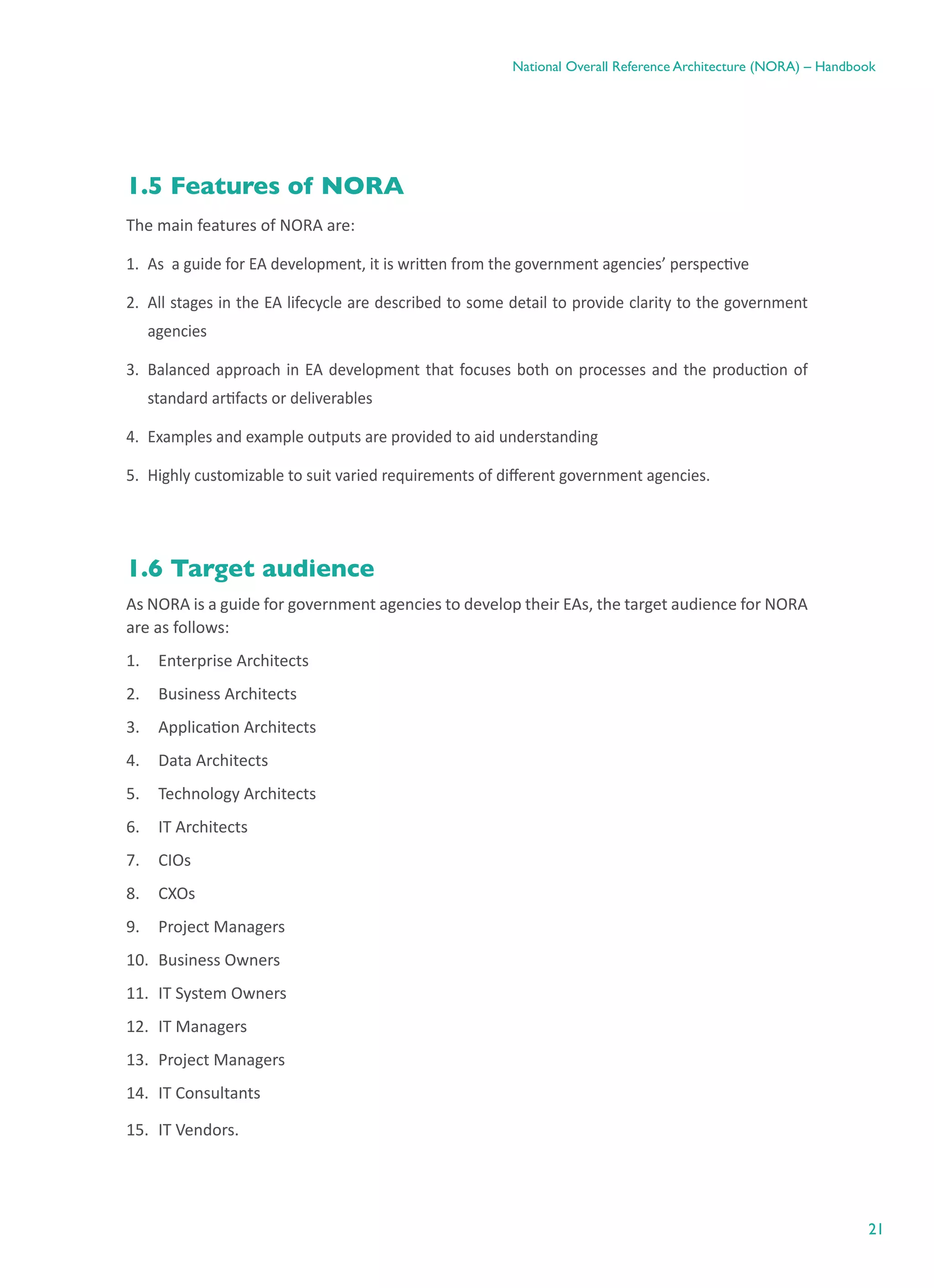

1.5.	 Features of NORA	 21
1.6.	 Target audience	 21
1.7.	 Document structure	 22
1.8.	 Related information	 22
1.9.	 Contact information	 22

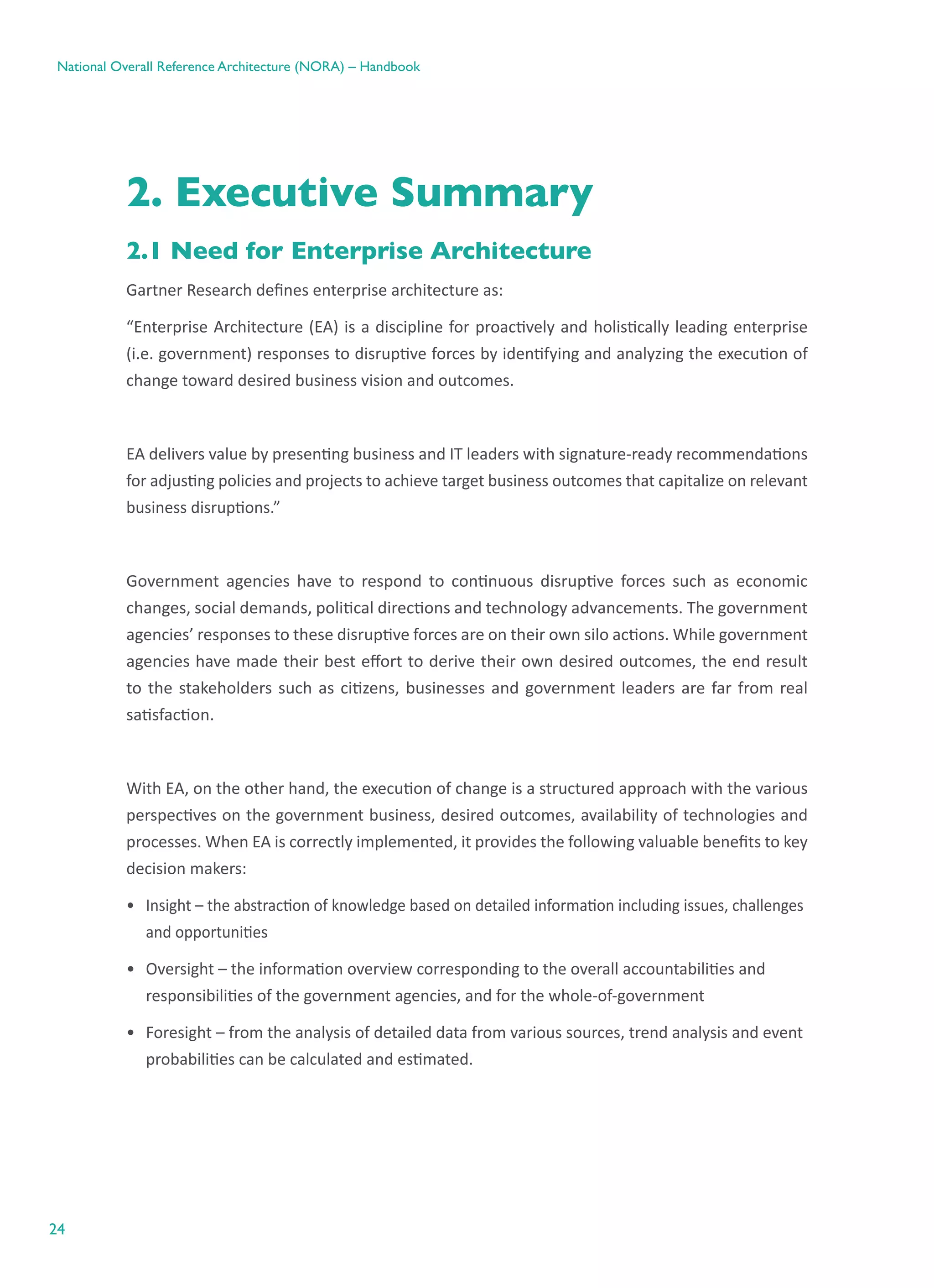

2.	 Executive Summary	 24
2.1.	 Need for Enterprise Architecture	 24
2.2.	 Background of NEA Framework	 26
2.3.	 Objectives of NORA	 28
2.4.	 Defining a purpose for agency EA	 28
2.5.	 NORA methodology	 30

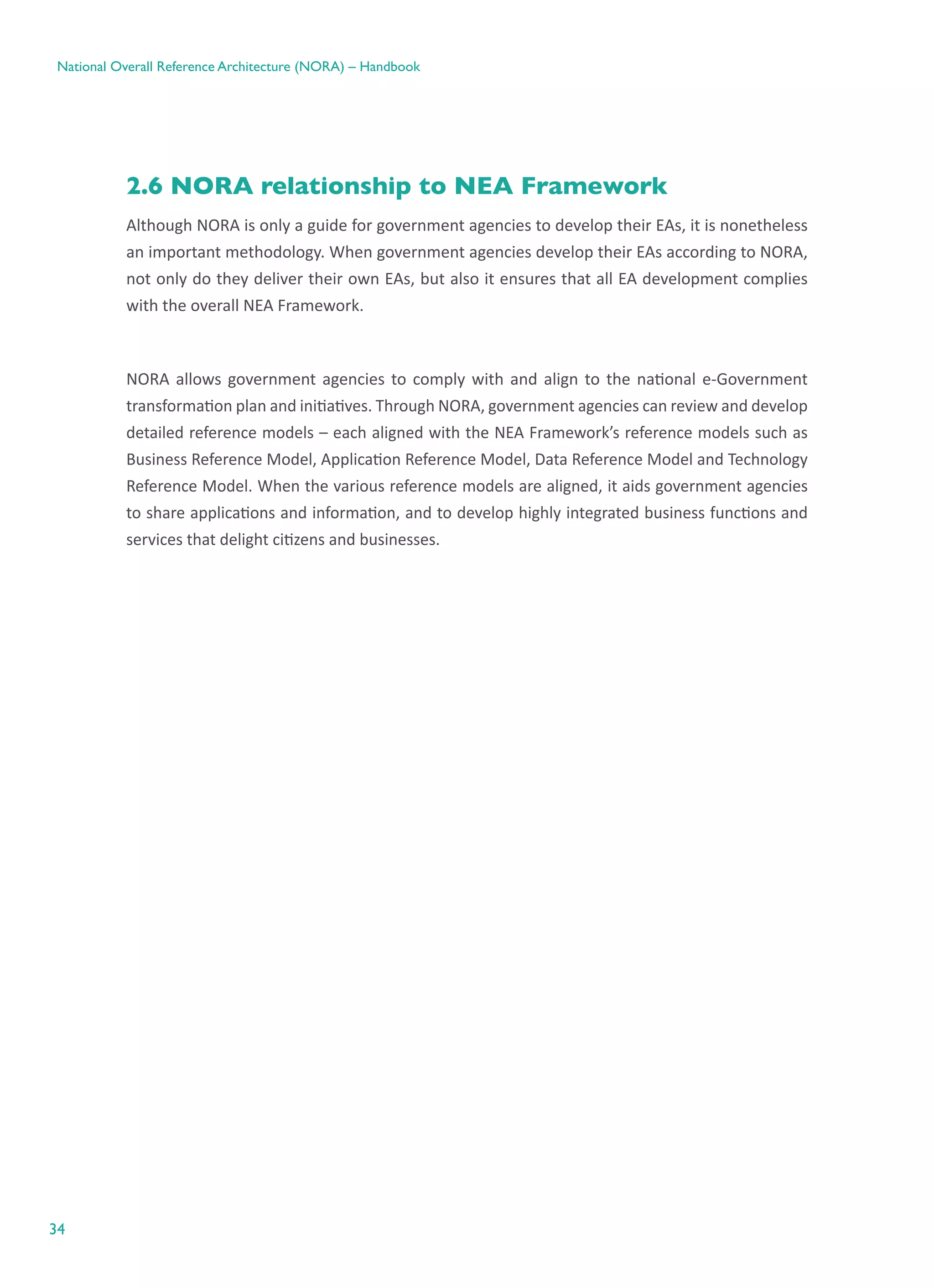

2.6.	 NORA relationship to NEA Framework	 34

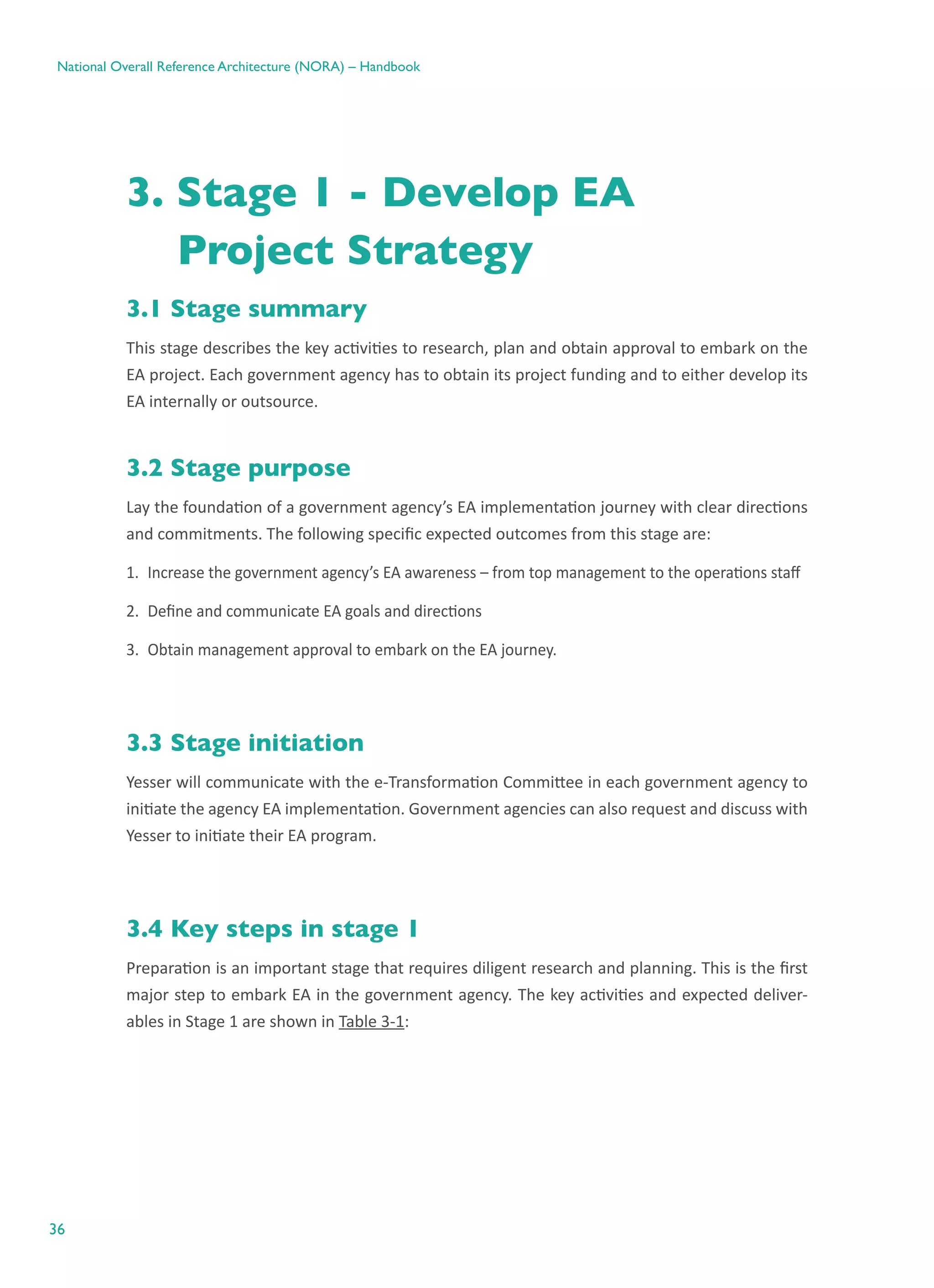

3.	 Stage 1 - Develop EA Project Strategy	 36
3.1.	 Stage summary	 36
3.2.	 Stage purpose	 36
3.3.	 Stage initiation	 36

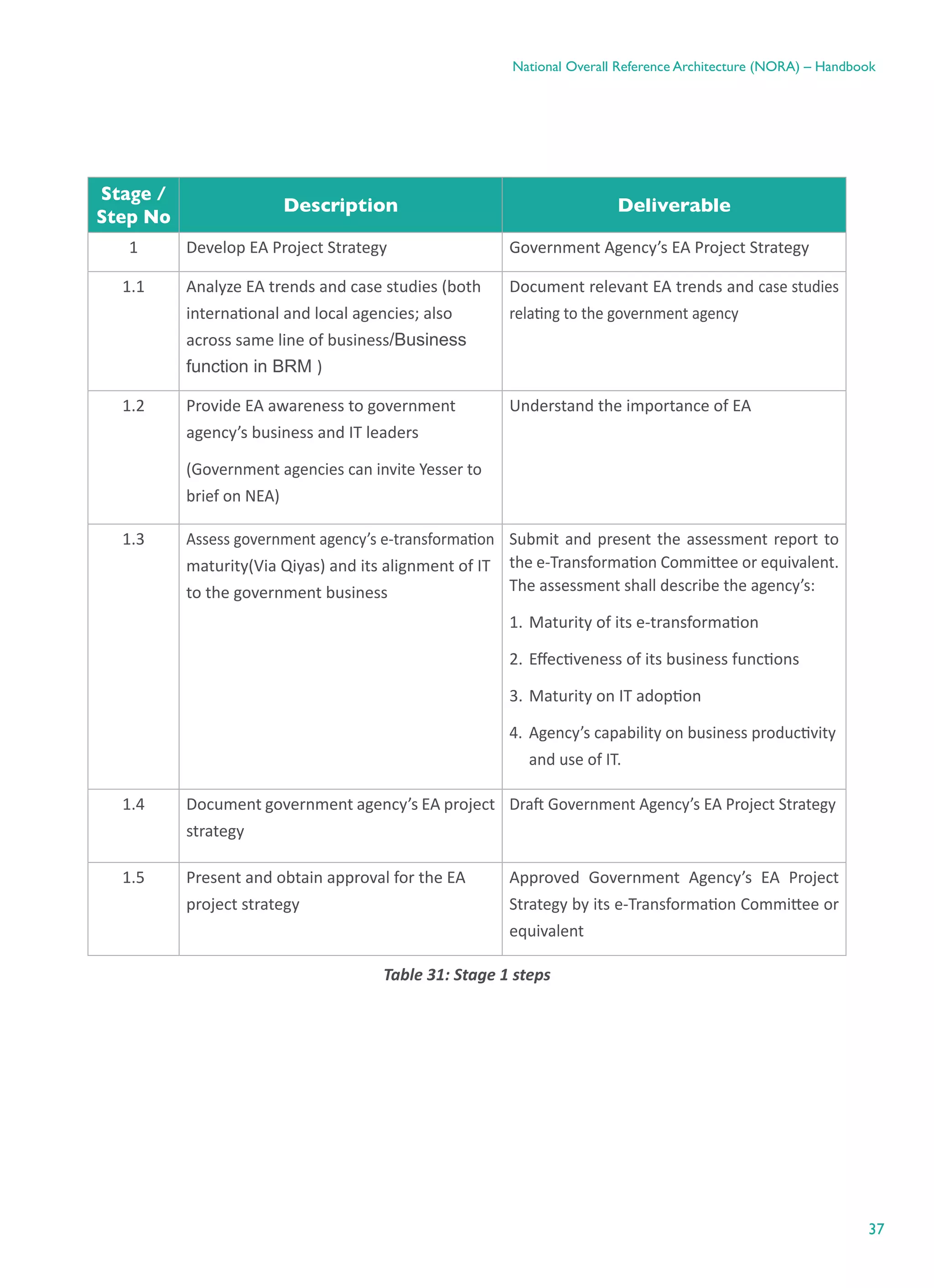

3.4.	 Key steps in stage 1	 36

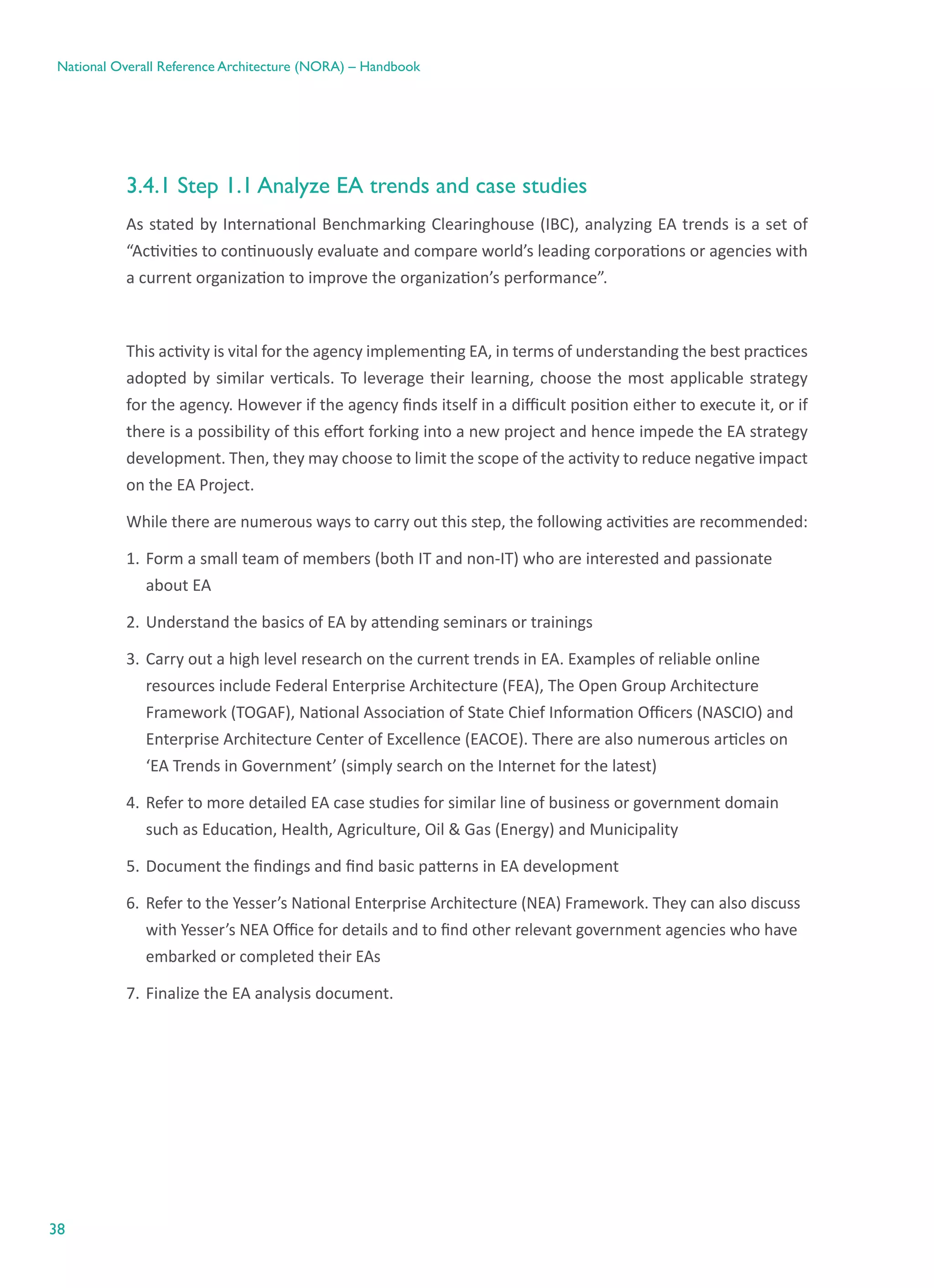

	 3.4.1 Step 1.1 Analyze EA trends and case studies	 38
	 3.4.2  Step 1.2 Provide EA awareness	 39

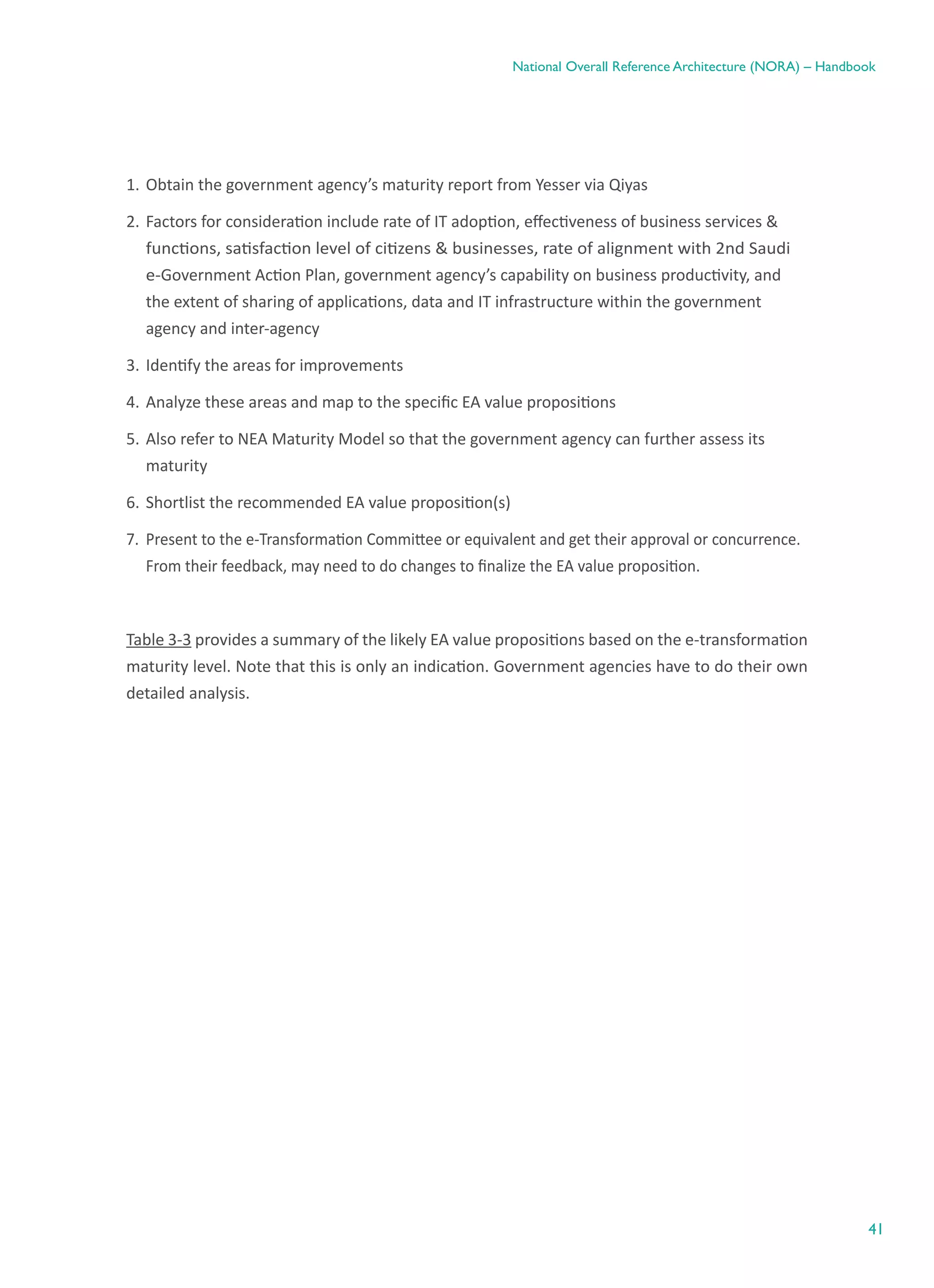

	 3.4.3. Step 1.3 Assess government agency’s e-transformation maturity	 40
	 3.4.4. Step 1.4 Document government agency’s EA project strategy	 44

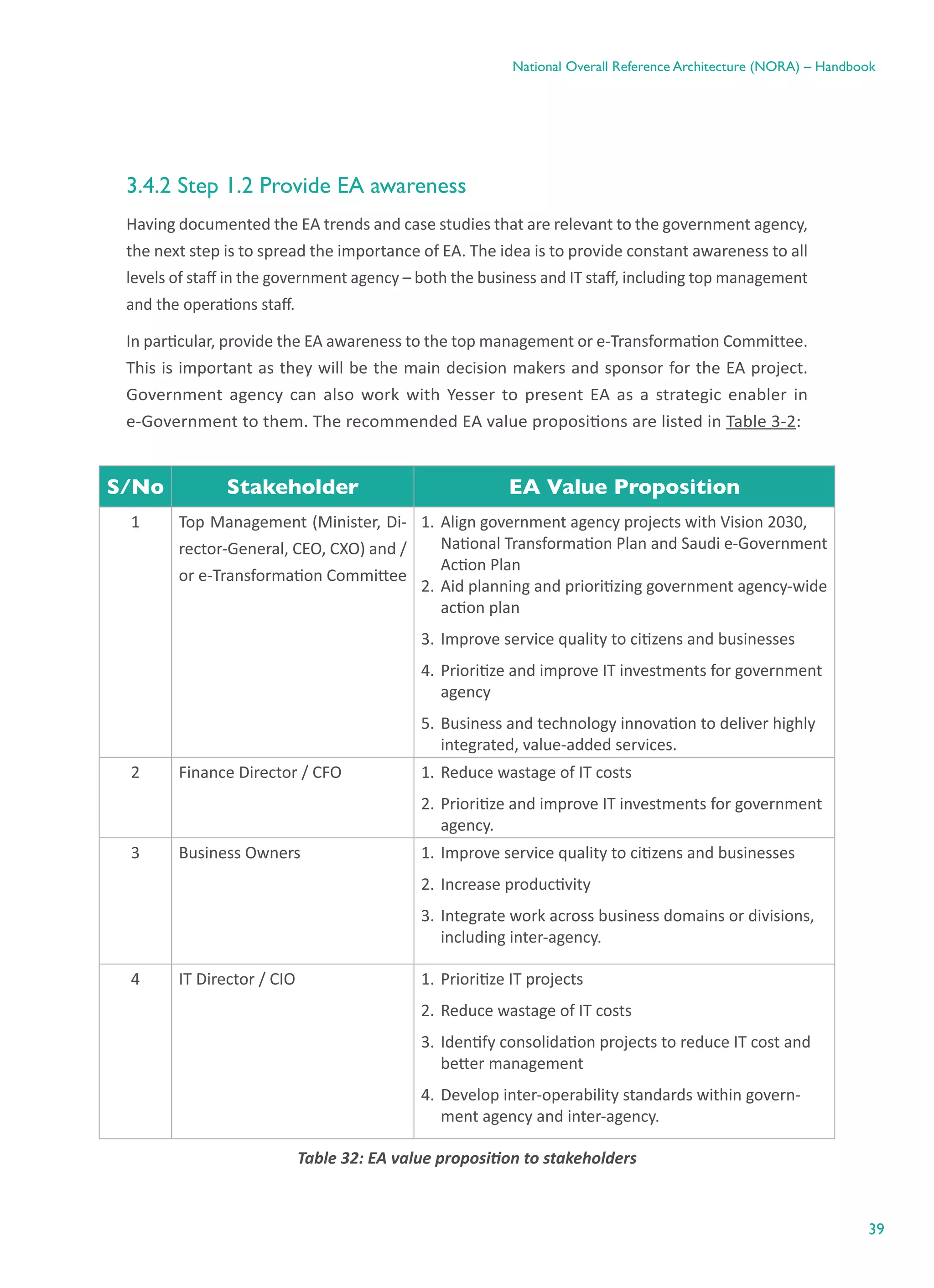

	 3.4.5. Step 1.5 Present and obtain approval for EA project strategy	 46
4
National Overall Reference Architecture (NORA) – Handbook

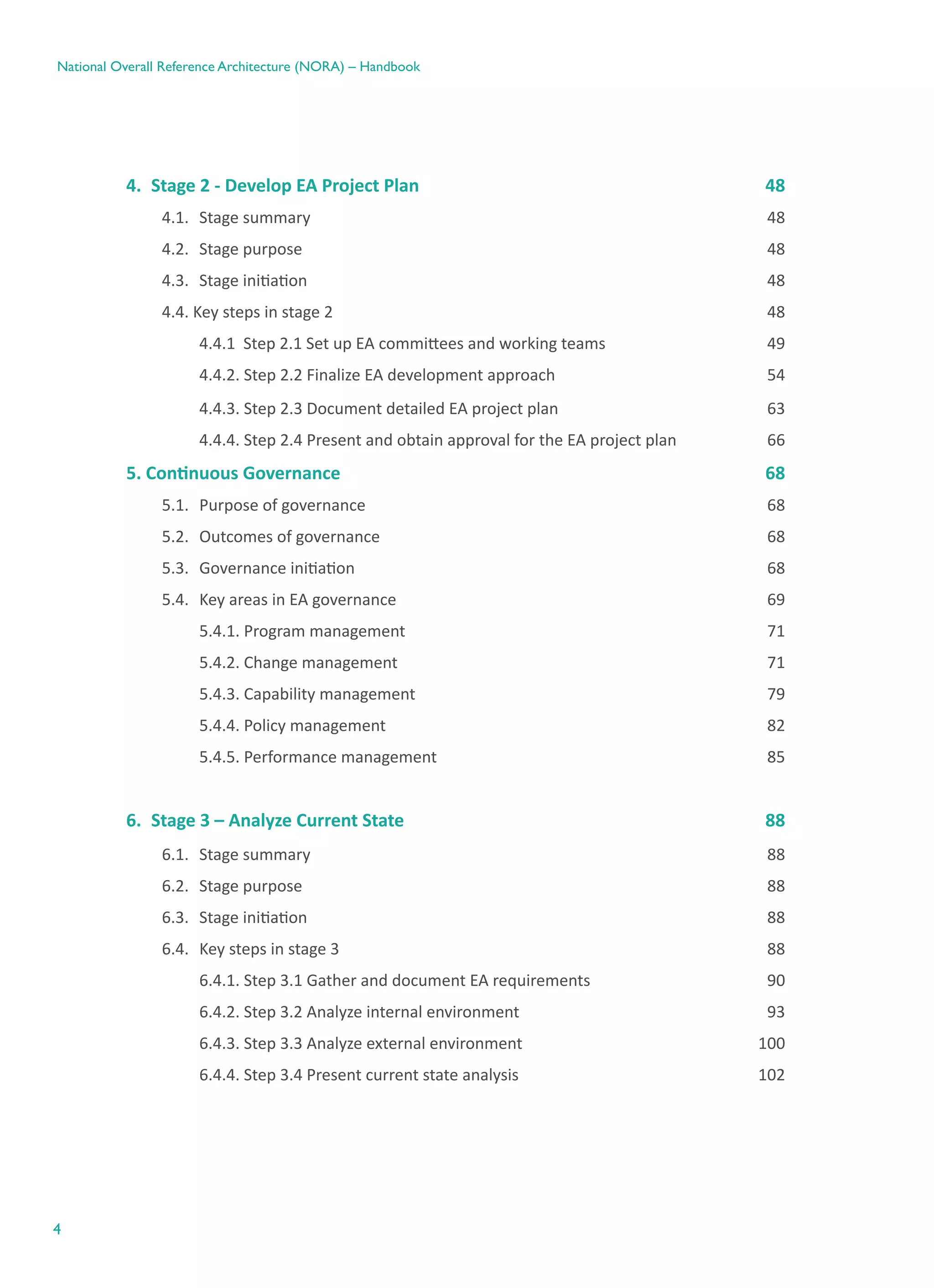

4.	 Stage 2 - Develop EA Project Plan	 48
4.1.	 Stage summary	 48
4.2.	 Stage purpose	 48
4.3.	 Stage initiation	 48
4.4. Key steps in stage 2	 48
	 4.4.1  Step 2.1 Set up EA committees and working teams	 49
	 4.4.2. Step 2.2 Finalize EA development approach	 54

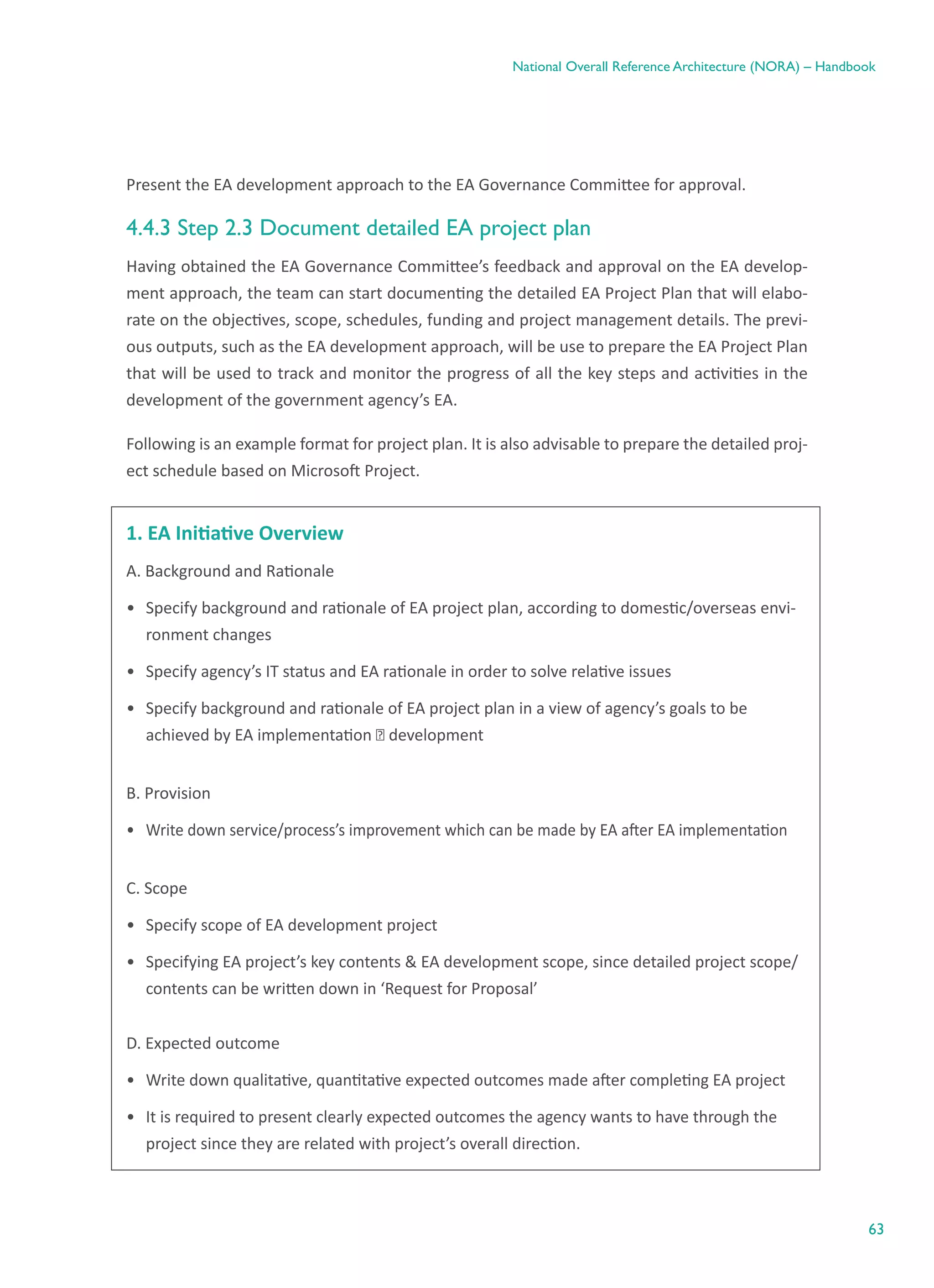

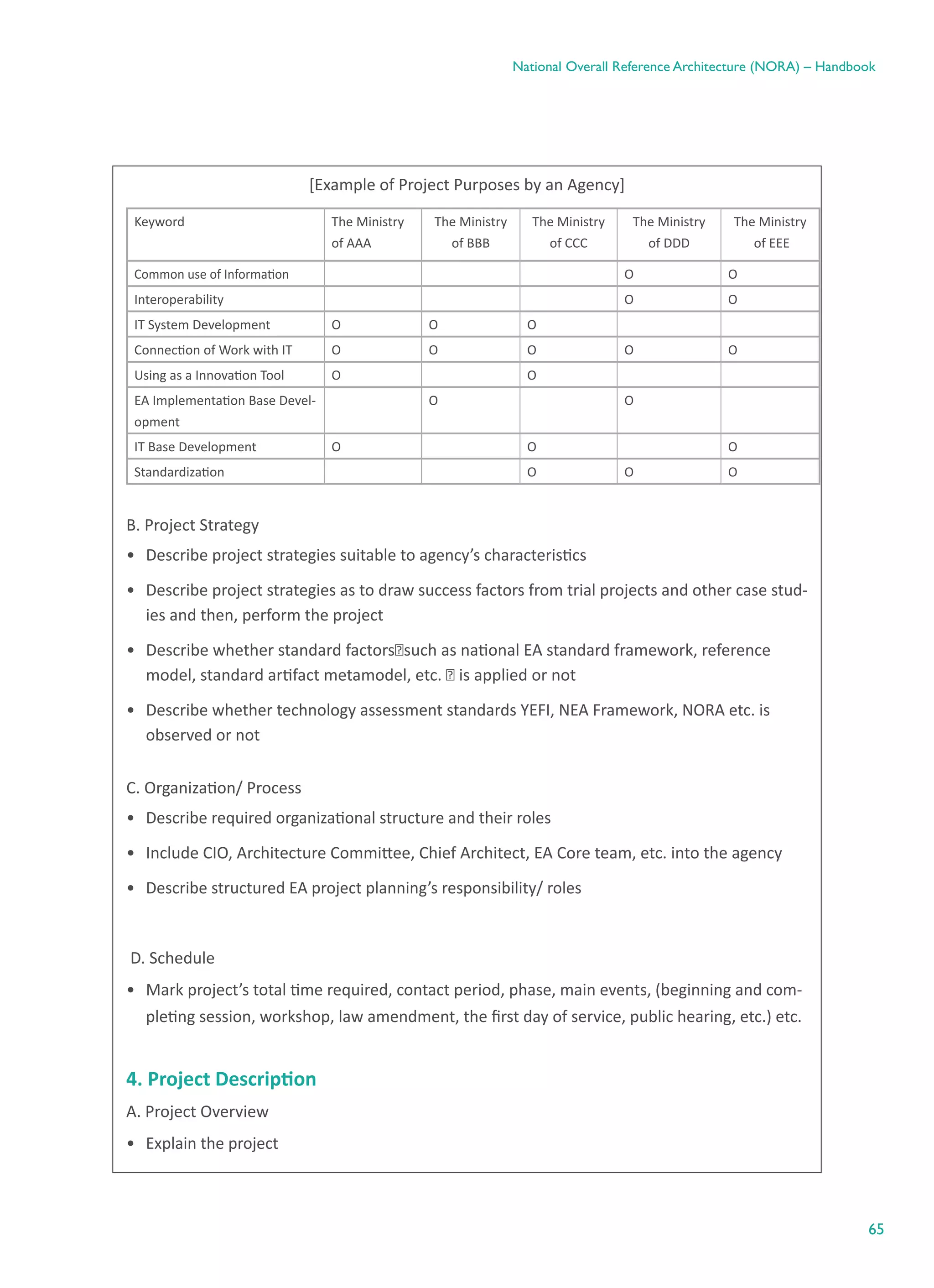

	 4.4.3. Step 2.3 Document detailed EA project plan	 63
	 4.4.4. Step 2.4 Present and obtain approval for the EA project plan	 66
5. Continuous Governance	 68
5.1.	 Purpose of governance	 68
5.2.	 Outcomes of governance	 68
5.3.	 Governance initiation	 68

5.4.	 Key areas in EA governance	 69

	 5.4.1. Program management	 71
	 5.4.2. Change management	 71
	 5.4.3. Capability management	 79

	 5.4.4. Policy management	 82
	 5.4.5. Performance management	 85
6.	 Stage 3 – Analyze Current State	 88
6.1.	 Stage summary	 88
6.2.	 Stage purpose	 88
6.3.	 Stage initiation	 88
6.4.	 Key steps in stage 3	 88

	 6.4.1. Step 3.1 Gather and document EA requirements	 90
	 6.4.2. Step 3.2 Analyze internal environment	 93
	 6.4.3. Step 3.3 Analyze external environment	 100

	 6.4.4. Step 3.4 Present current state analysis	 102
5
National Overall Reference Architecture (NORA) – Handbook
7.	 Stage 4 – Develop EA Framework	 104
7.1.	 Stage summary	 104
7.2.	 Stage purpose	 104

7.3.	 Stage initiation	 105
7.4.	 Key steps in stage 4	 105
	 7.4.1. Step 4.1 Define EA’s vision and mission statements, & architecture objectives	106
	 7.4.2. Step 4.2 Define EA’s architecture principles	 109
	7.4.3. Step 4.3 Present and obtain approval for EA vision, mission and
        	              architecture objectives	111
	 7.4.4. Step 4.4 Define EA Framework structure	 111
	 7.4.5. Step 4.5 Design EA architecture elements	 113
	 7.4.6. Step 4.6 Design EA model	 114

	 7.4.7. Step 4.7 Develop EA documentation standard	 119
	 7.4.8. Step 4.8 Develop EA artifacts management processes	 121
	 7.4.9. Step 4.9 Present and obtain approval for EA framework	 121

8.	 About Reference Models & Architectures	 123
8.1.	 Need for clarity	 123

8.2.	 Definitions	 123
8.3.	 Process to build reference models and architectures	 125
8.4.	 Building blocks of reference models and architectures	 127
8.5.	 Summary of deliverables for reference models and architectures	 129

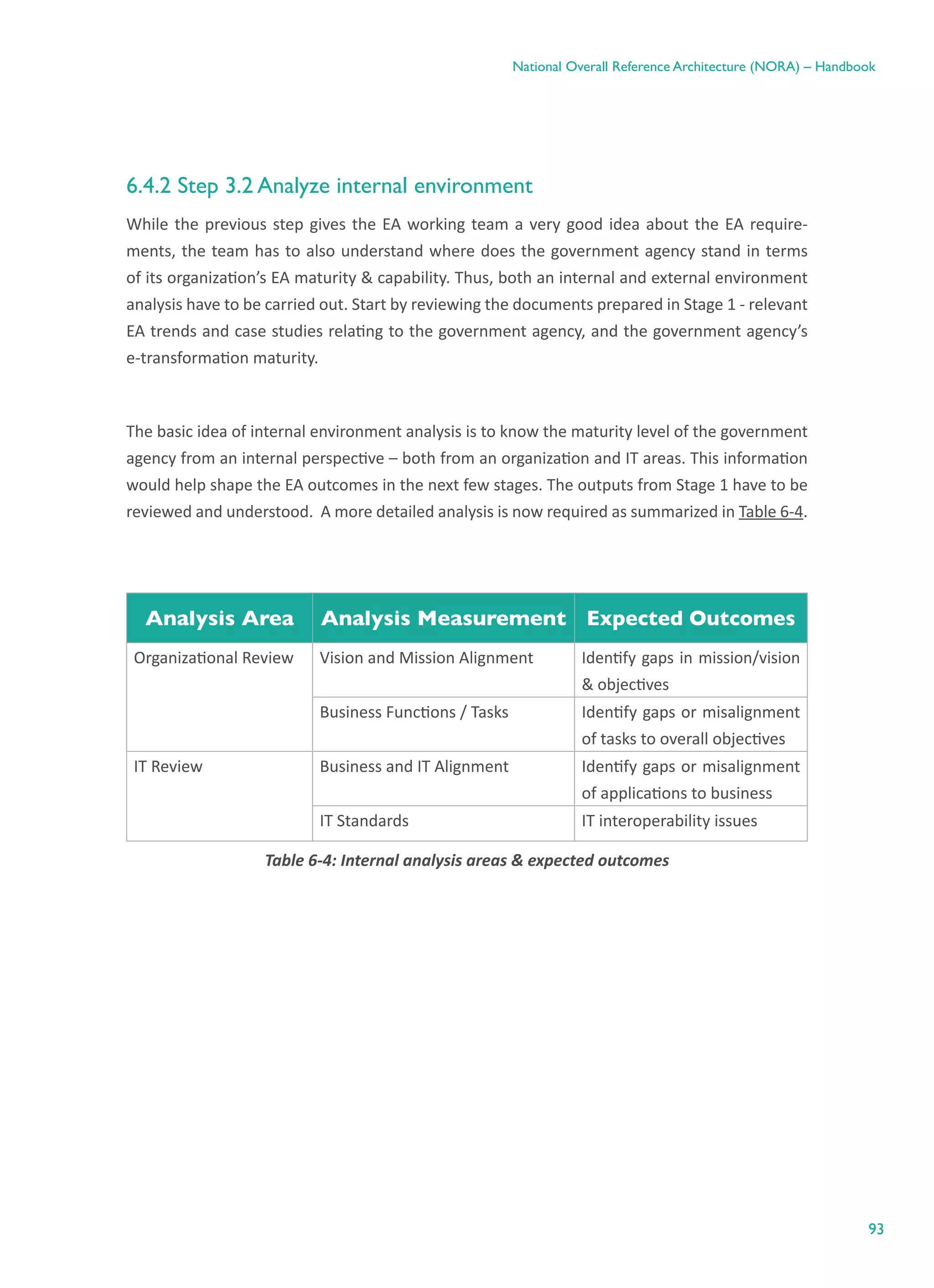

9.	 Stage 5 – Build Reference Models	 133
9.1.	 Stage summary	 133
9.2.	 Stage purpose	 133
9.3.	 Stage initiation	 133
9.4.	 About NEA reference models	 134
9.5.	 Key steps in stage 5	 136

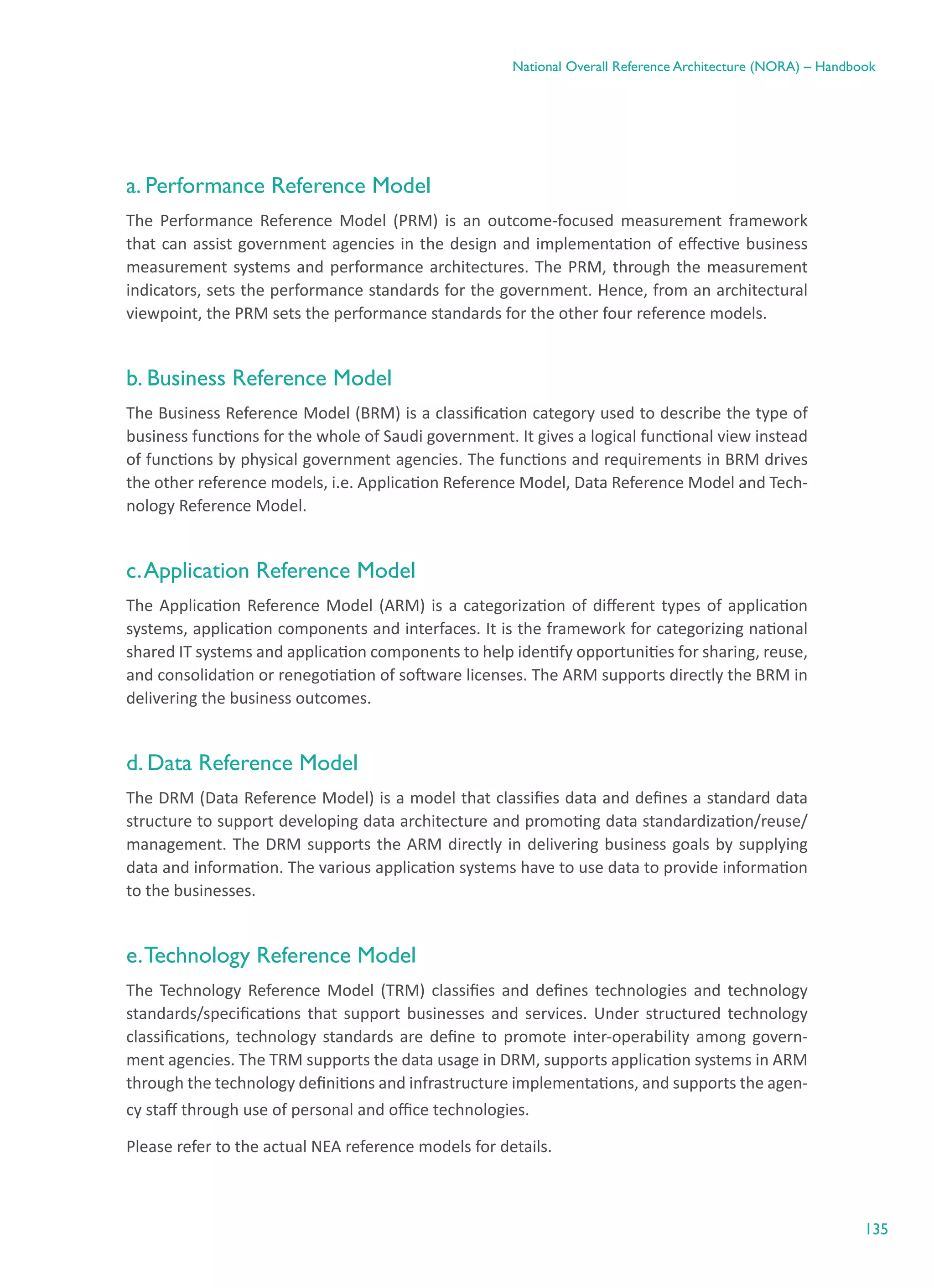

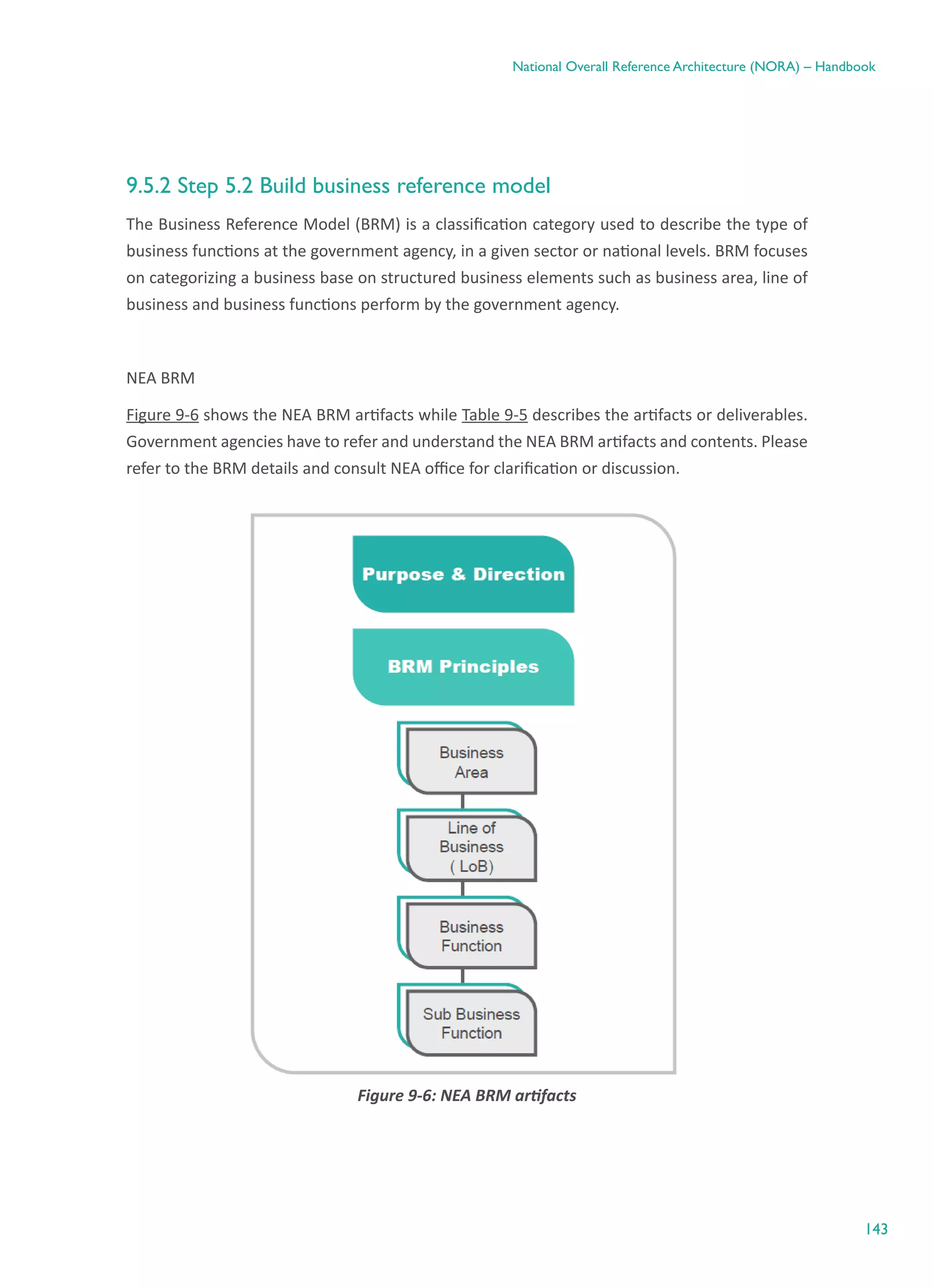

	 9.5.1. Step 5.1 Build performance reference model	 137

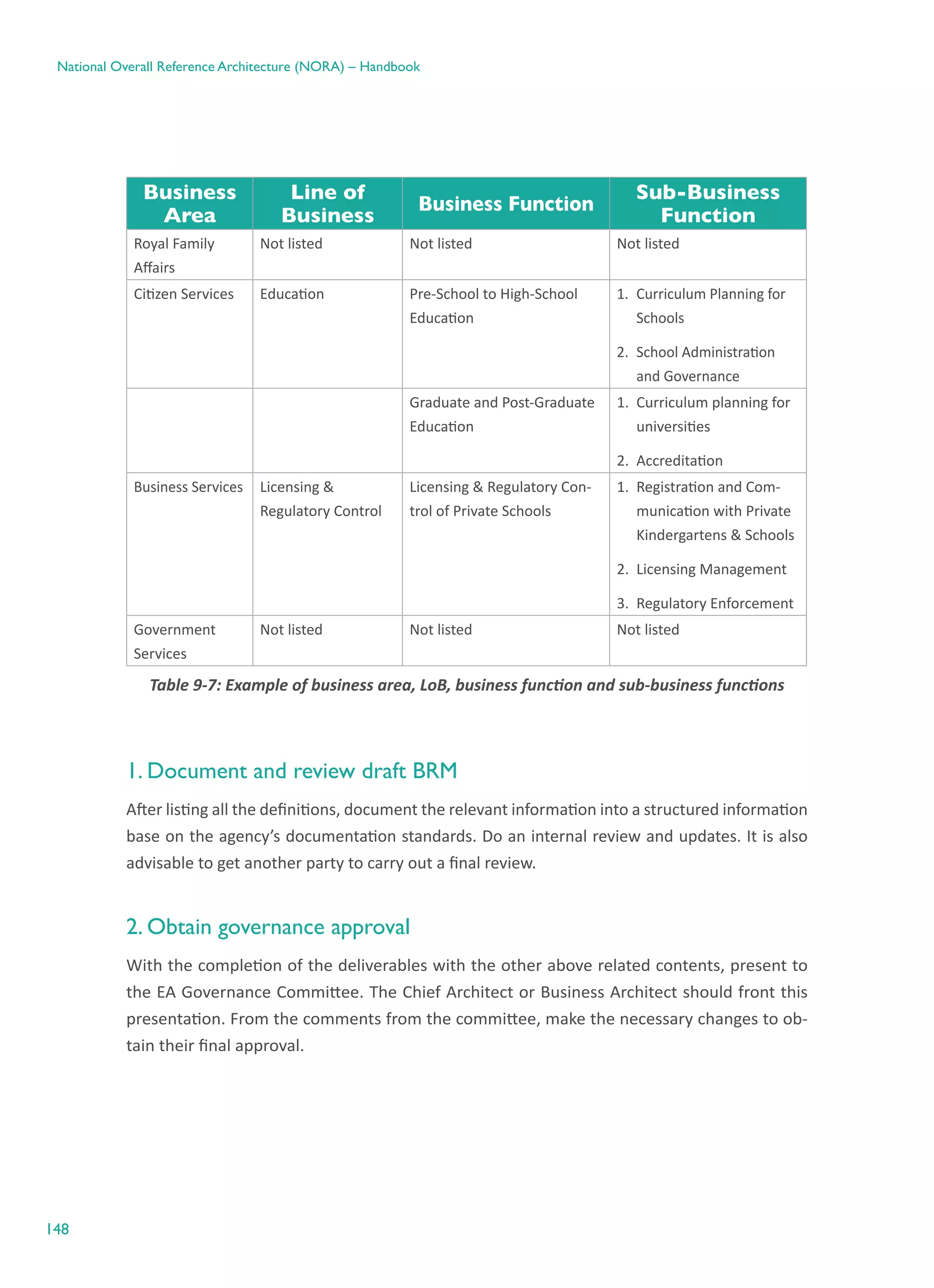

	 9.5.2. Step 5.2 Build business reference model	 143
6
National Overall Reference Architecture (NORA) – Handbook

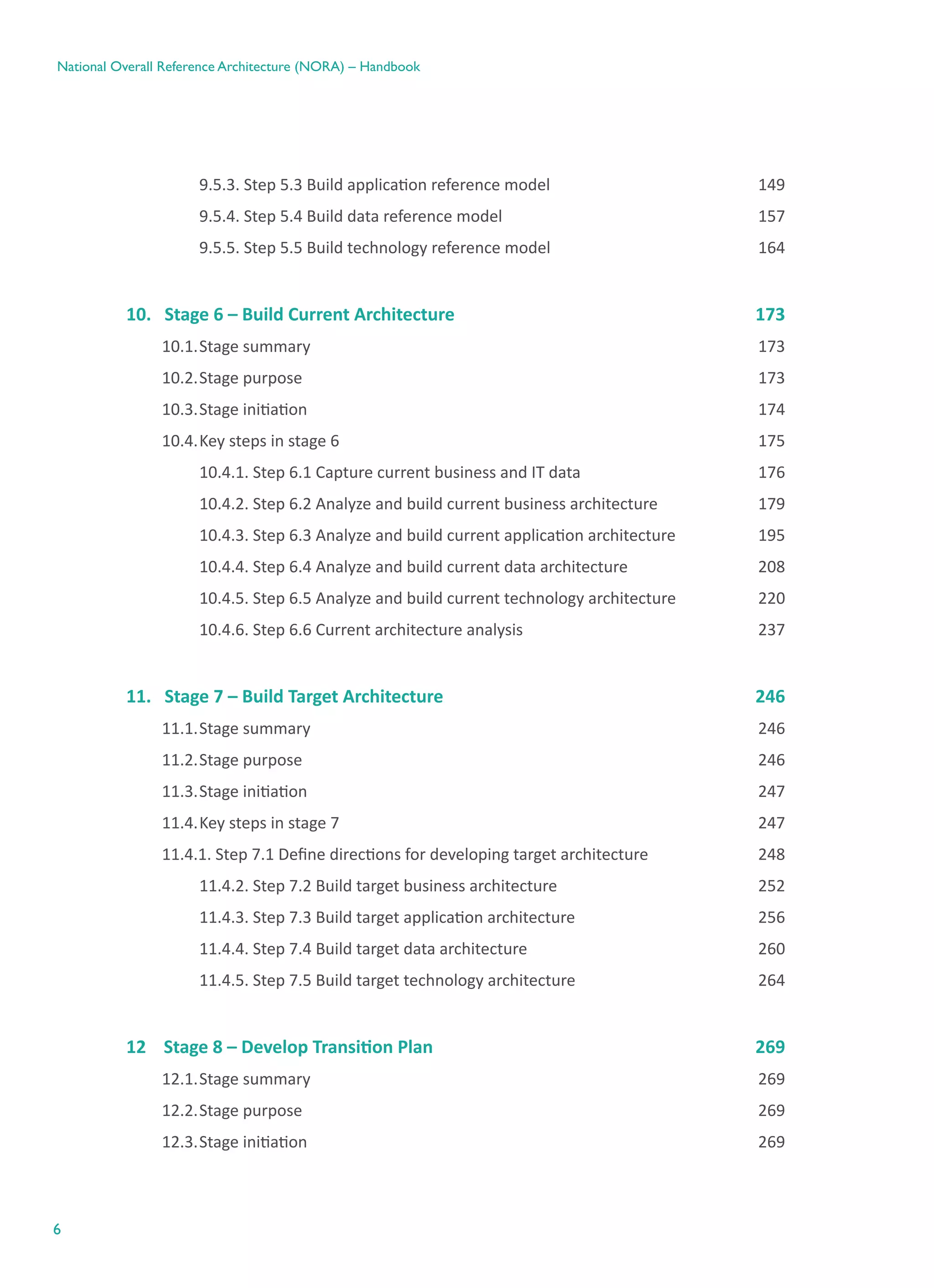

	 9.5.3. Step 5.3 Build application reference model	 149

	 9.5.4. Step 5.4 Build data reference model	 157
	 9.5.5. Step 5.5 Build technology reference model	 164

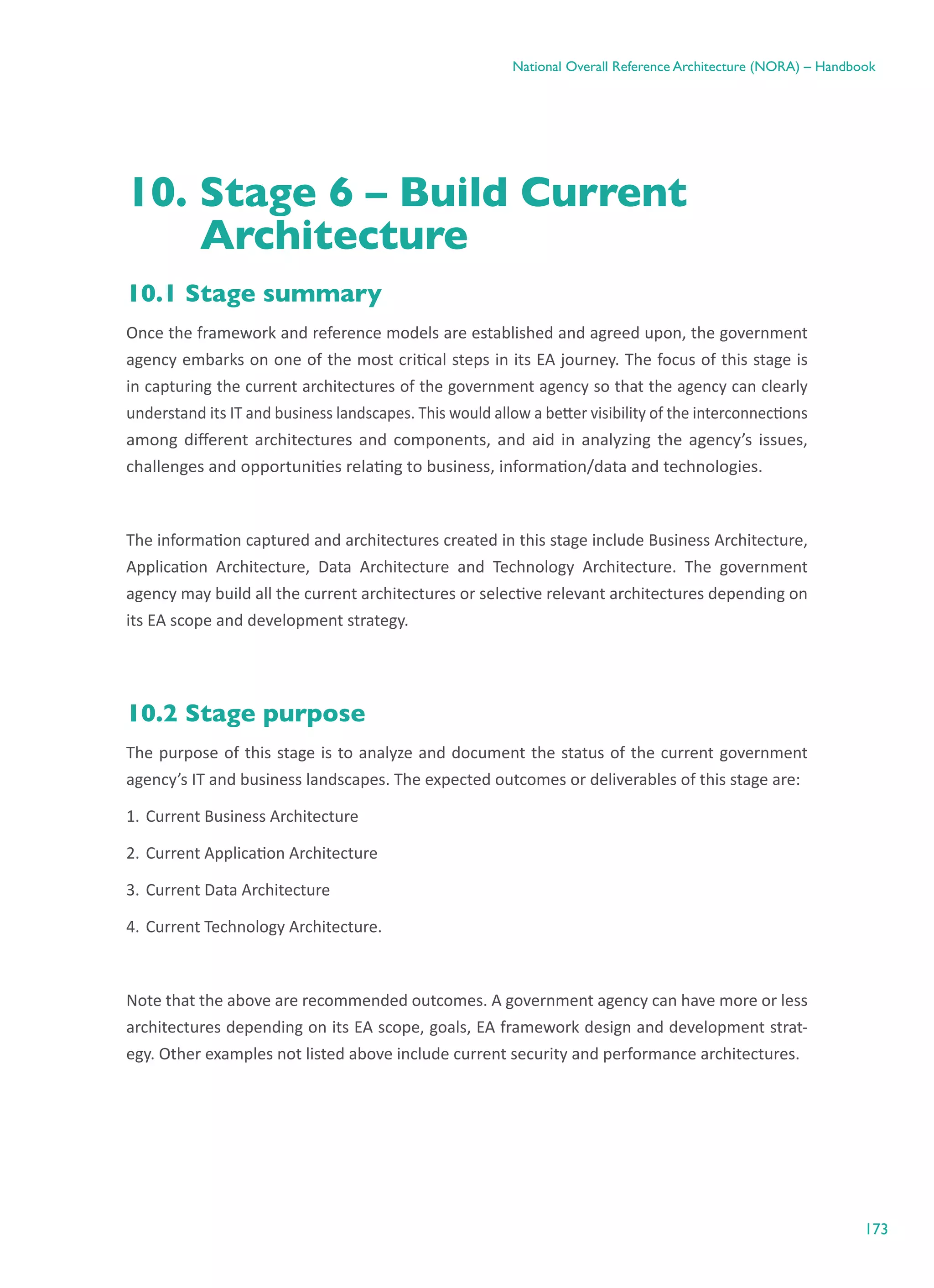

10.   Stage 6 – Build Current Architecture	 173
10.1.	Stage summary	 173
10.2.	Stage purpose	 173
10.3.	Stage initiation	 174

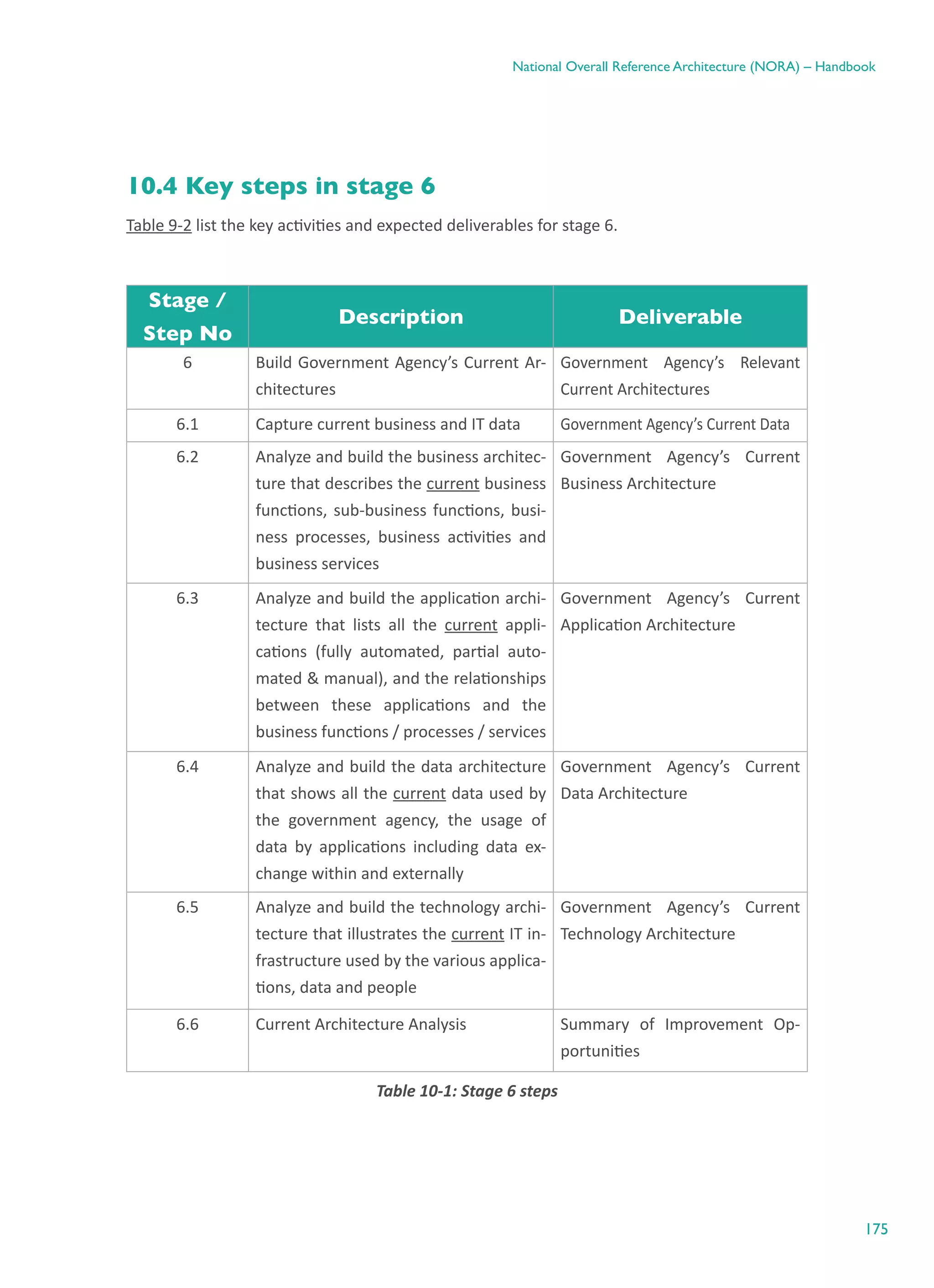

10.4.	Key steps in stage 6	 175
	 10.4.1. Step 6.1 Capture current business and IT data	 176
	 10.4.2. Step 6.2 Analyze and build current business architecture	 179
	 10.4.3. Step 6.3 Analyze and build current application architecture	 195

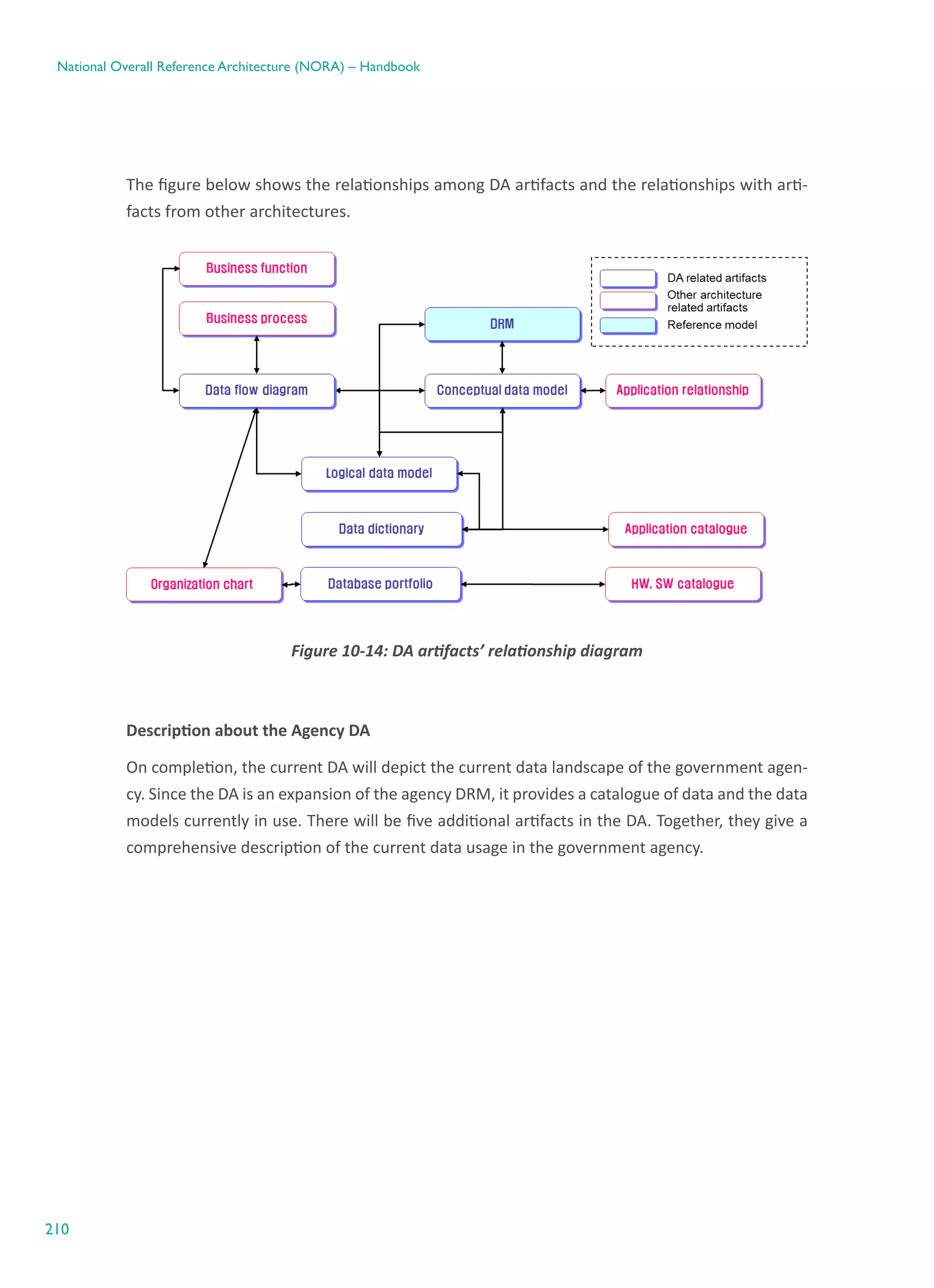

	 10.4.4. Step 6.4 Analyze and build current data architecture	 208
	 10.4.5. Step 6.5 Analyze and build current technology architecture	 220
	 10.4.6. Step 6.6 Current architecture analysis	 237
11.   Stage 7 – Build Target Architecture	 246
11.1.	Stage summary	 246

11.2.	Stage purpose	 246
11.3.	Stage initiation	 247
11.4.	Key steps in stage 7	 247
11.4.1. Step 7.1 Define directions for developing target architecture	 248
	 11.4.2. Step 7.2 Build target business architecture	 252

	 11.4.3. Step 7.3 Build target application architecture	 256
	 11.4.4. Step 7.4 Build target data architecture	 260
	 11.4.5. Step 7.5 Build target technology architecture	 264
12    Stage 8 – Develop Transition Plan	 269
12.1.	Stage summary	 269
12.2.	Stage purpose	 269
12.3.	Stage initiation	 269
7
National Overall Reference Architecture (NORA) – Handbook
12.4.	Key steps in stage 8	 270

	 12.4.1. Step 8.1 Define transition projects	 270
	 12.4.2. Step 8.2 Prioritize transition projects	 271
	 12.4.3. Step 8.3 Create transition roadmap	 274

	 12.4.4. Step 8.4 Analyze and document required resources and outcomes	 277
	 12.4.5. Step 8.5 Obtain governance approval	 279
13.   Stage 9 – Develop Management Plan	 281
13.1.	Stage summary	 281
13.2.	Stage purpose	 281
13.3.	Stage initiation	 281
13.4.	Key steps in stage 9	 282

	 13.4.1. Step 9.1 Develop EA usage plan	 282

         13.4.2. Step 9.2 Develop EA management plan	 288
14.   Stage 10 – Execute and Maintain	 300
14.1.	Stage Summary	 300
14.2.	Stage Purpose	 300
14.3.	Stage Initiation	 300
14.4.	Key Steps in Stage 10	 301

	 14.4.1. Step 10.1 Implement the EA usage & management plan	 301
	 14.4.2. Step 10.2 Implement the EA transition roadmap	 305
Annex A : NORA Summary of Deliverables by Stages	 307
Annex B : NEA System and EAMS	 321
B.1. NEA System Overview	 321
B.2. Agency EAMS	 323
Annex C : NEA Meta-Model	 324
C.1. Overview of NEA Meta-model	 324

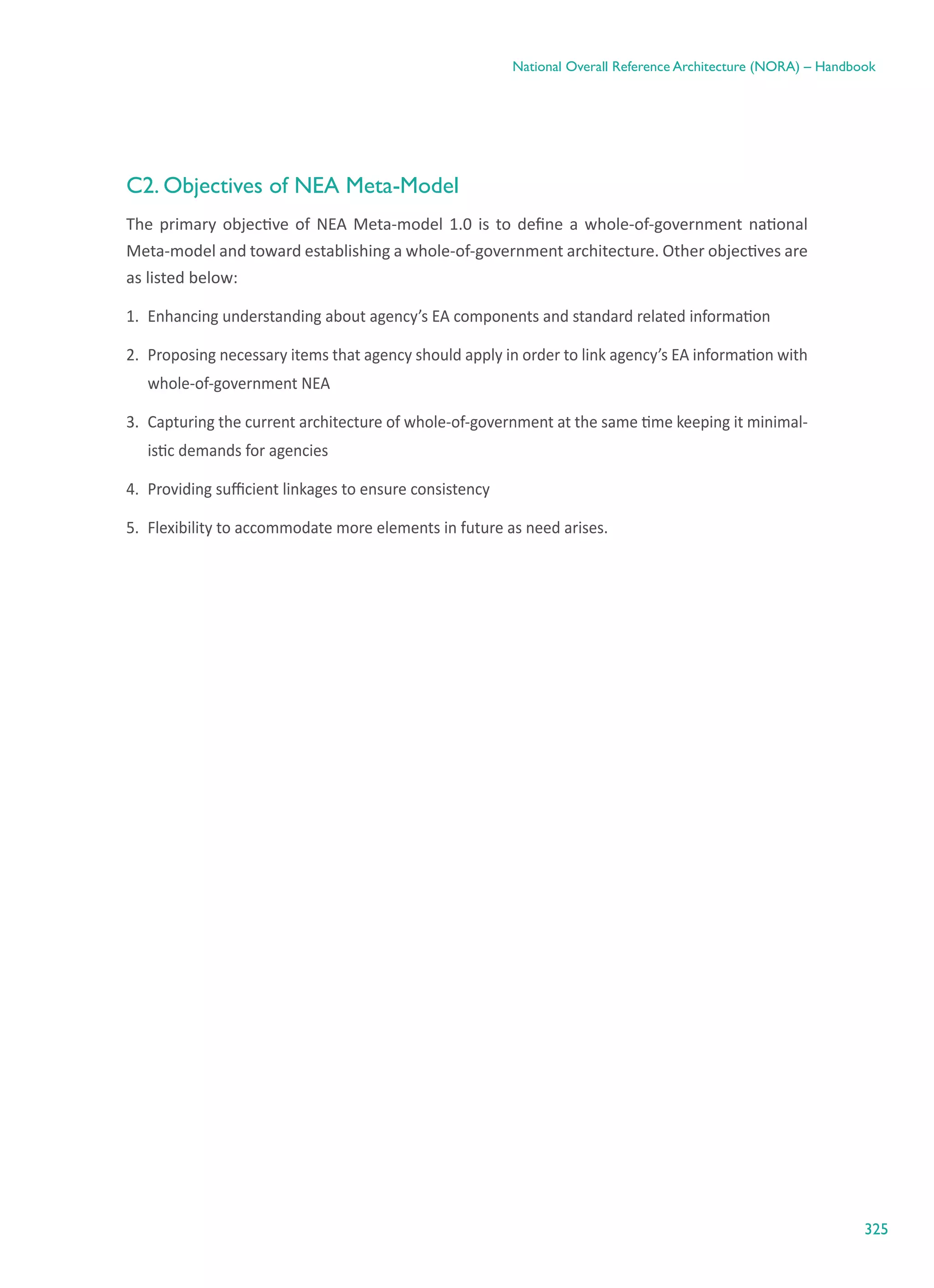

C.2. Objectives of NEA Meta-Model	 325

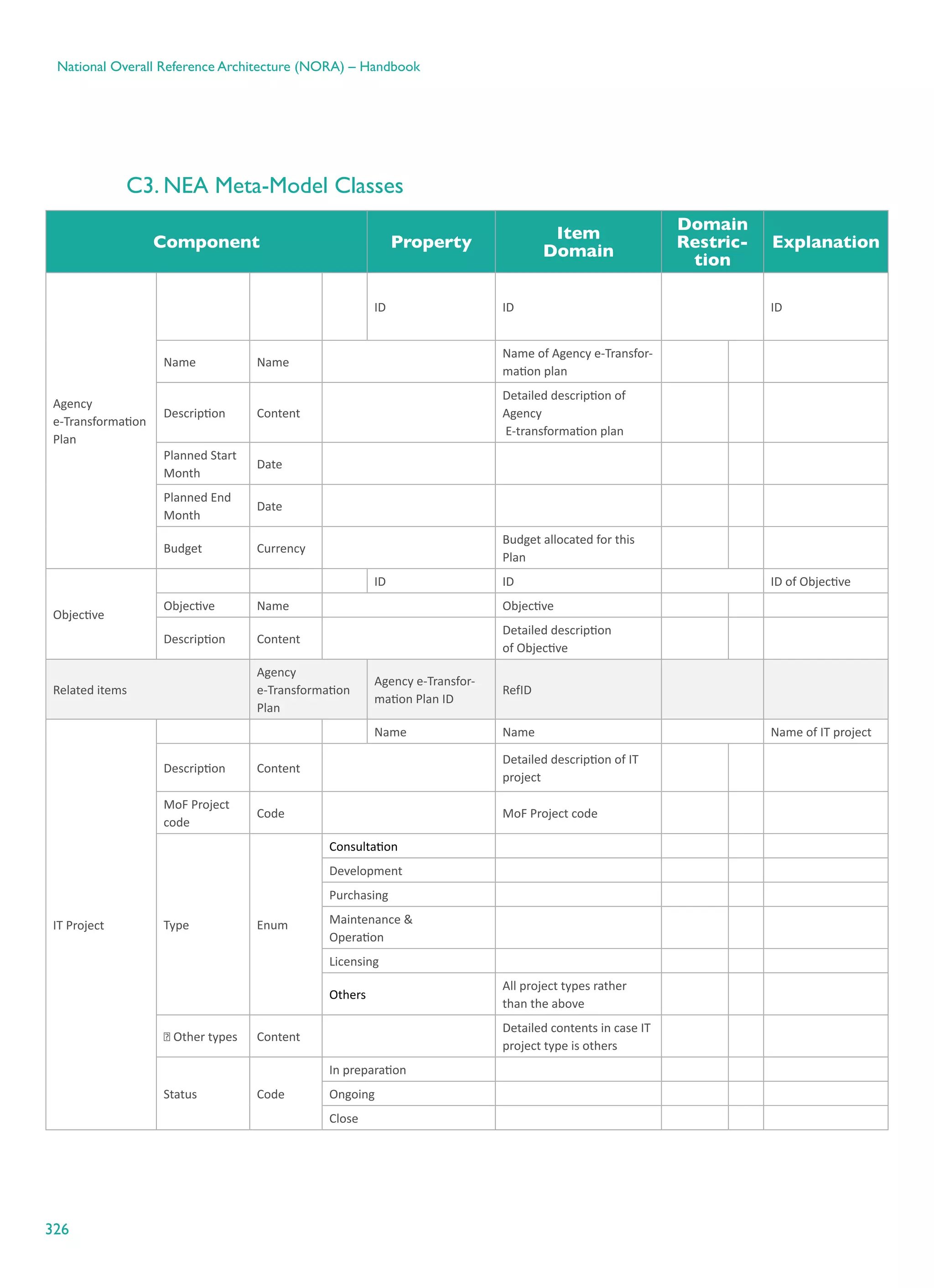

C.3. NEA Meta-Model Classes	 326
8
National Overall Reference Architecture (NORA) – Handbook
Annex D :e-Government Transformation Plan	 336
D.1. Mandates of A Government Entity	 336
D.2. Strategic e-Government Transformation in an Agency	 336
D.3. Overview of e-Government Transformation Plan	 338
D.4. How to use NORA for developing e-Government Transformation Plan	 339
D.5. Relevant Artifacts for e-Government Transformation	 341
D.6. Exhaustive list of e-Government Transformation artifacts	 344
Annex E : NEA EA maturity model	 345
Annex F : Business Service Attributes	 348
9
National Overall Reference Architecture (NORA) – Handbook
Table of Figures
Figure ‎2-1: Impact of EA on government	 25
Figure ‎2-2: NEA Framework	 26
Figure ‎2-3: NORA Methodology	 33
Figure ‎3-1: Example of bottom-up development strategy	 46
Figure ‎3-2: Example of mixed development approach	 46
Figure ‎4-1: Example of EA organizational structure	 51
Figure ‎4-2: Example of EA transition roadmap	 59
Figure ‎4-3: Example format for EA project plan	 65
Figure ‎5-1: Five Aspects of EA governance	 70
Figure ‎5-2: Example of artifact review and approval process	 74
Figure ‎53: Example for EA usage direction	 83
Figure ‎54: Example for EA management plan direction	 85
Figure ‎61: Example of Vision/Mission alignment with goals and initiatives	 95
Figure ‎62: Example of business and IT alignment	 97
Figure ‎63: Example of major IT systems supporting government functions	 98
Figure ‎64: Example of IT systems supporting government functions by business areas	 99
Figure ‎71: Example of a Vision statement	 106
Figure ‎72: Example of EA architecture principles	 110
Figure ‎73: EA Framework structure example	 113
Figure ‎8-1: Basic process in building reference models and architectures	 126
Figure ‎8-2: Building blocks / components	 127
Figure ‎8-3: Same building blocks in NEA reference models	 128
Figure ‎9-1: NEA reference models and their inter-relationships	 134
Figure ‎9-2: NEA PRM artifacts	 137
Figure ‎9-3: Example PRM purpose and direction	 139
Figure ‎9-4: Example PRM strategic goals / outcomes	 140
Figure ‎9-5: Example of PRM indicator description	 142
Figure ‎9-6: NEA BRM artifacts	 143
Figure ‎9-7: Example BRM purpose	 146
Figure ‎9-8: Example of business area, LoB, business function and sub-business functions	 147
10
National Overall Reference Architecture (NORA) – Handbook
Figure ‎9-9: NEA ARM artifacts	 149
Figure ‎9-10: Structured diagram of application systems, components and interfaces in NEA ARM	 151
Figure ‎9-11: Agency ARM artifacts	 152
Figure ‎9-12: Example ARM purpose or direction	 153
Figure ‎9-13: Example of MOE’s business and sub-business functions	 155
Figure ‎9-14: NEA DRM artifacts	 157
Figure ‎9-15: NEA DRM	 158
Figure ‎9-16: Agency DRM artifacts	 159
Figure ‎9-17: Example for defining DRM purpose	 161
Figure ‎9-18: Example for developing data classification structure	 162
Figure ‎9-19: NEA TRM artifacts	 165
Figure ‎9-20: Example TRM purpose	 168
Figure ‎9-21: Example TRM structure	 168
Figure ‎10-1: Data capturing activities	 176
Figure ‎10-2: Difference between BRM and BA	 180
Figure ‎10-3: BA artifacts’ relationship diagram	 181
Figure ‎10-4: Organizational chart example	 184
Figure ‎10-5: Business area, LoB, business function and sub-business function diagram example	186
Figure ‎10-6: The properties of business function description	 189

Figure ‎10-7: Contents of a sub-business function	 188
Figure ‎10-8: MOE’s sub-business function & business process relationship	 189

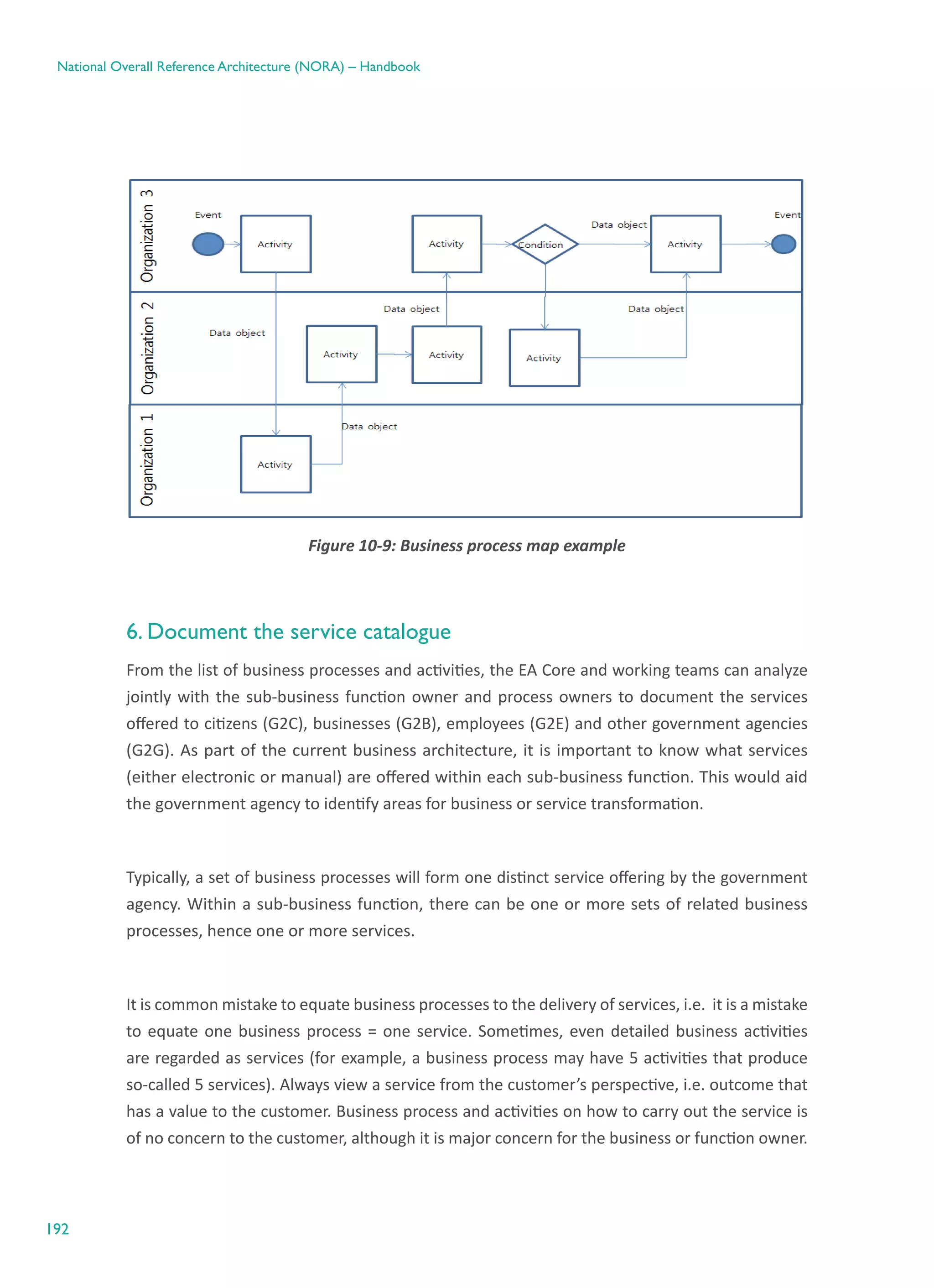

Figure ‎10-9: Business process map example	 192
Figure ‎10-10: Difference between ARM and AA	 196
Figure ‎10-11: AA artifacts’ relationship diagram	 197
Figure ‎10-12: Application overview example	 200
Figure ‎10-13: Difference between DRM and DA	 209
Figure ‎10-14: DA artifacts’ relationship diagram	 210
Figure ‎10-15: Conceptual data model example	 213
Figure ‎10-16: Logical data model example	 214

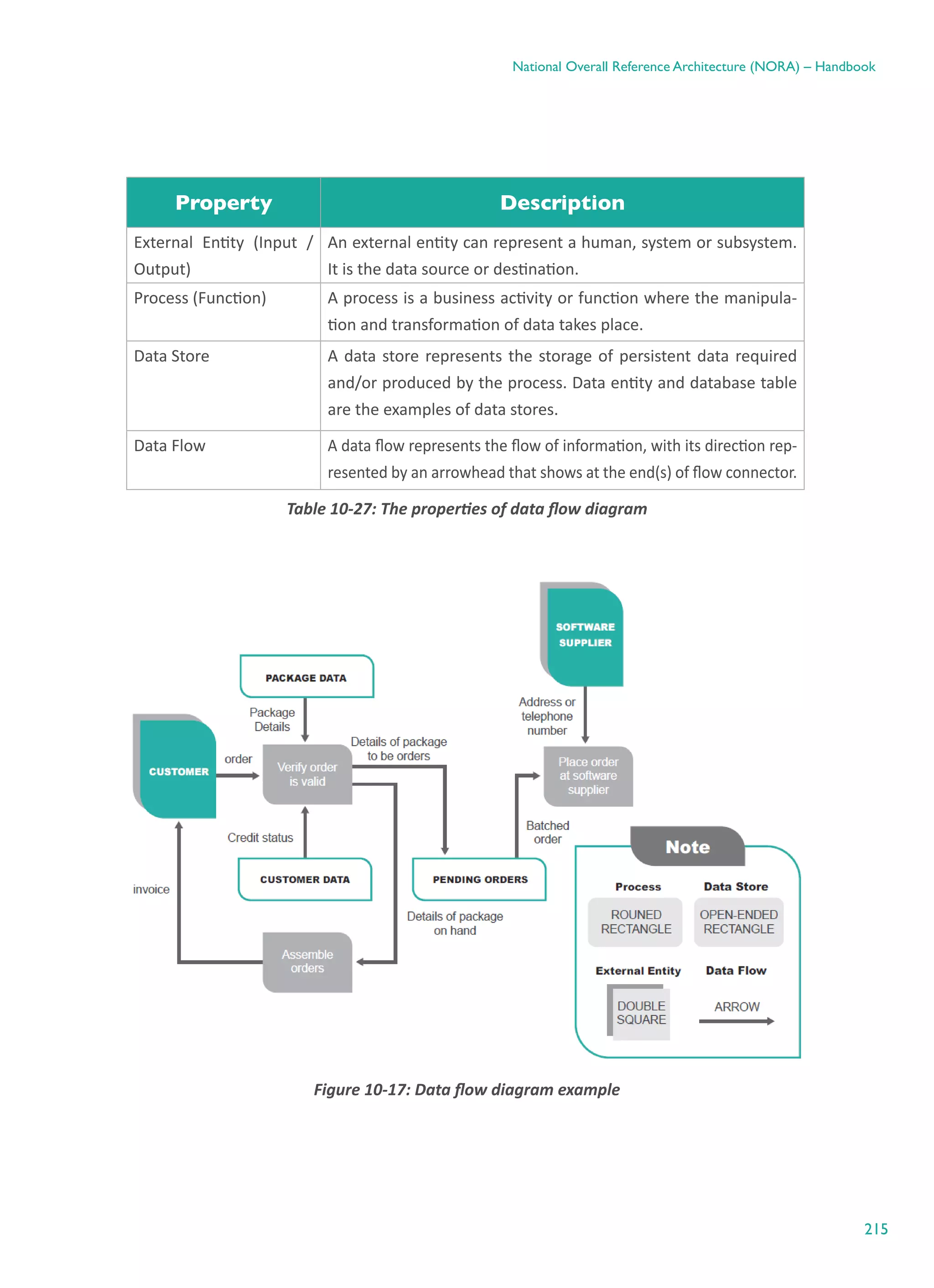

Figure ‎10-17: Data flow diagram example	 215
Figure ‎10-18: Difference between TRM and TA	 221
11
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-19: Relationship TA artifacts	 222
Figure ‎10-20: Infrastructure overview example	 225
Figure ‎10-21: WAN diagram example	 227
Figure ‎10-22: LAN diagram example	 228
Figure ‎10-23: Internet diagram example	 229
Figure ‎10-24: WLAN diagram example	 230
Figure ‎10-25: Storage diagram example	 231
Figure ‎10-26: Server farm diagram example	 232
Figure ‎10-27: Example BA analysis	 238

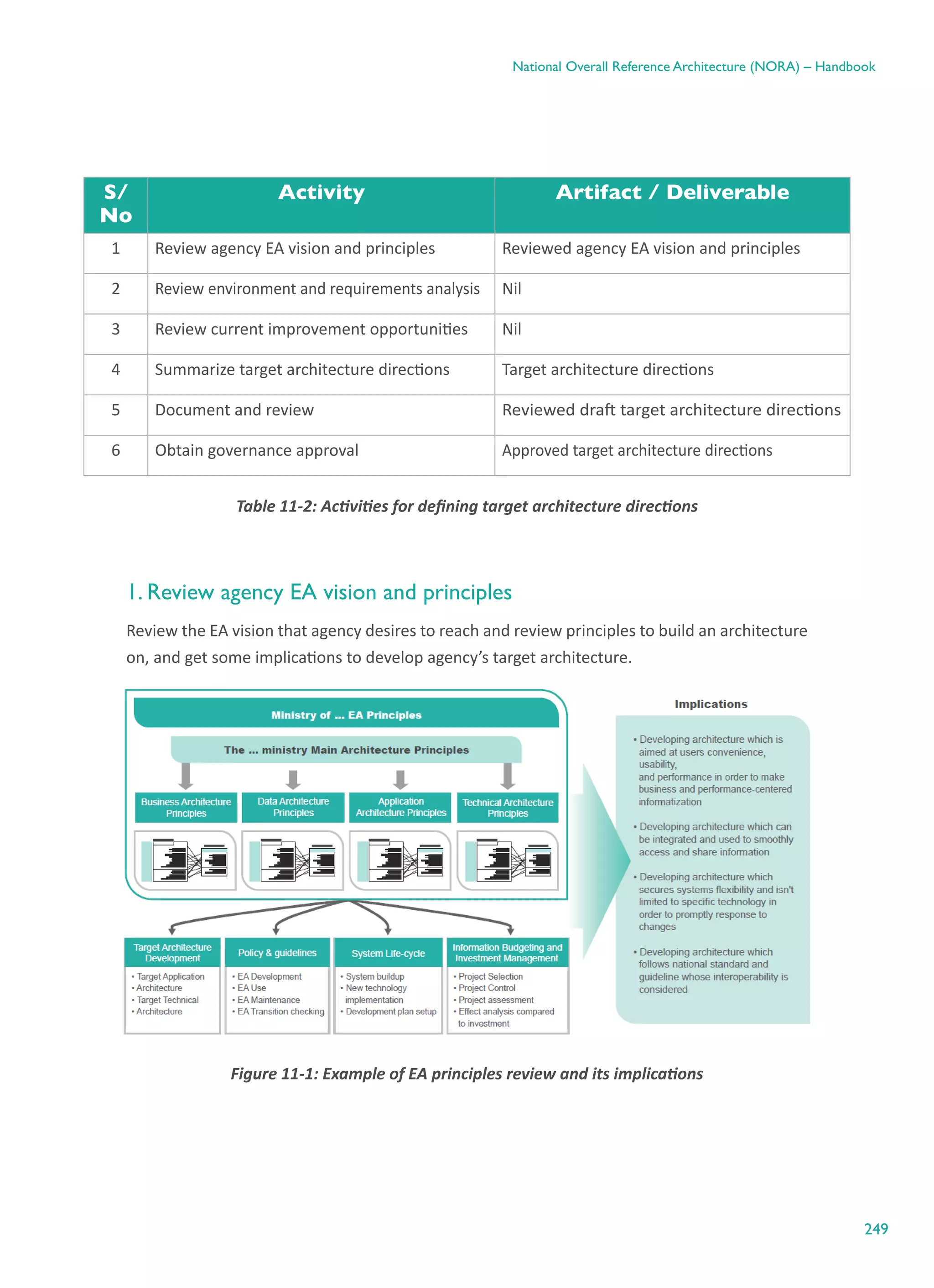

Figure ‎10-28: Example BA improvement opportunities	 239
Figure ‎10-29: Example AA analysis	 240

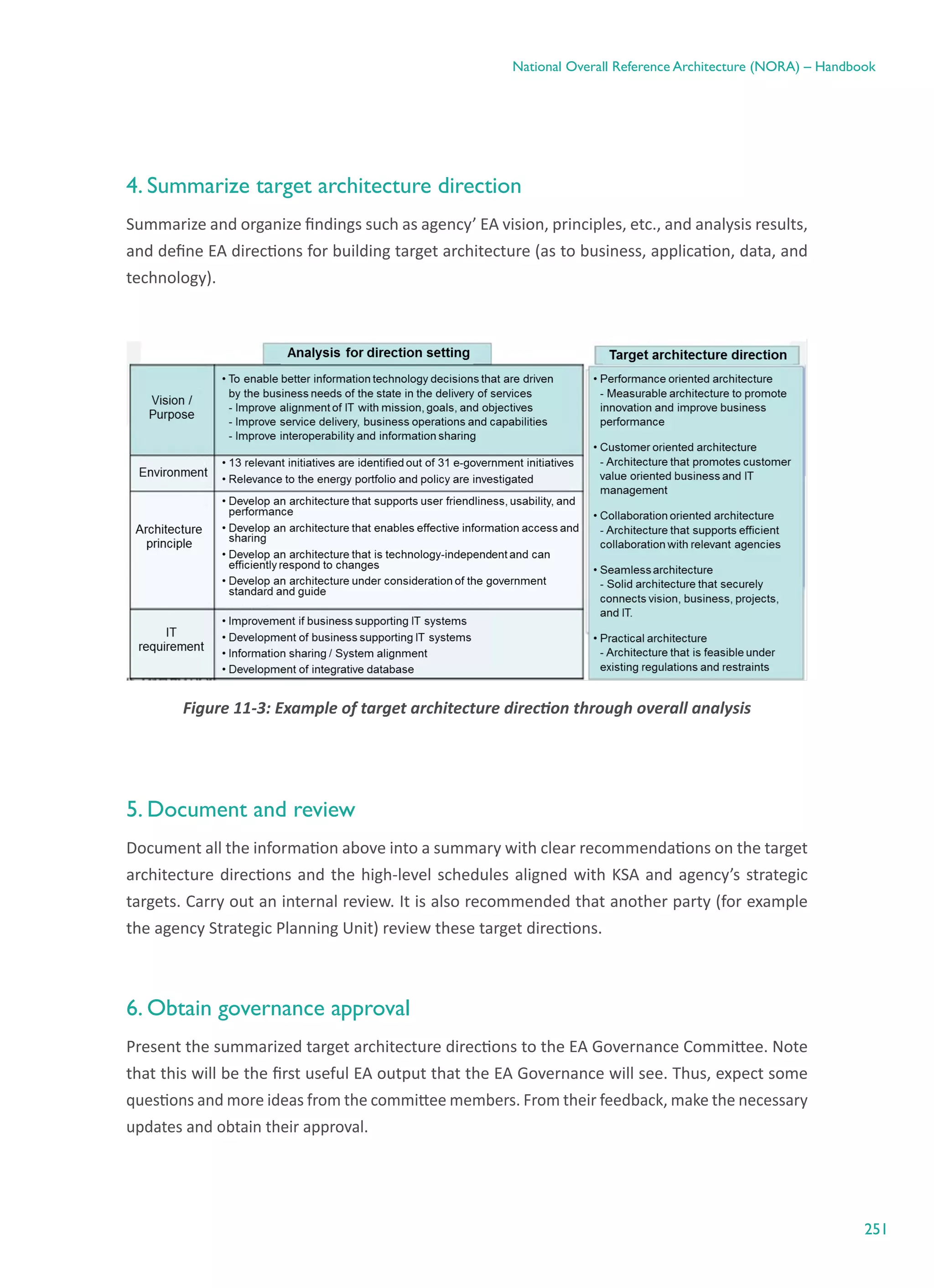

Figure ‎10-30: Example AA improvement opportunities	 240
Figure ‎10-31: Example DA analysis	 241
Figure ‎10-32: Example DA improvement opportunities	 242
Figure ‎10-33: Example TA analysis	 243
Figure ‎10-34: Example TA improvement opportunities	 243
Figure ‎11-1: Example of EA principles review and its implications	 249

Figure ‎11-2: Example agency improvement opportunities for various architectures	 250
Figure ‎11-3: Example of target architecture direction through overall analysis	 251

Figure ‎11-4: Example of updated business function in target BA	 254
Figure ‎11-5: Example of updated business processes in target BA	 255
Figure ‎11-6: Example process to identify new application systems & architecture	 258
Figure ‎11-7: Example of updated application function in target AA	 259
Figure ‎11-8: Example of identified artifacts for updates in target DA	 262
Figure ‎11-9: Example updated database diagram	 263
Figure ‎11-10: Example of direction setting for in TA	 266
Figure ‎11-11: Example of updated infrastructure overview in target TA	 267
Figure ‎12-1: Example selection method for transition plan	 271
Figure ‎12-2: Example of transition project	 271
Figure ‎12-3: Example prioritization principles	 272
Figure ‎12-4: Example priority assessment structure	 273
Figure ‎12-5: Example priority assessment	 273
12
National Overall Reference Architecture (NORA) – Handbook
Figure ‎12-6: Example transition projects by stages	 274
Figure ‎12-7: Example of goal setting for each stage	 275
Figure ‎12-8: Example detailed schedule by each stage	 275
Figure ‎12-9: Example resource estimation procedure	 276
Figure ‎12-10: Example required resource classification	 277
Figure ‎12-11: Example resource estimation	 277
Figure ‎12-12: Example resource requirements by stage	 277
Figure ‎12-13: Example expected outcome	 278
Figure ‎13-1: Example for EA usage purposes	 283
Figure ‎13-2: Example for EA usage scope	 284
Figure ‎13-3: Example for EA usage tasks	 286
Figure ‎13-5: Example for the relationship between EA tasks and artifacts	 287
Figure ‎13-6: Example of EA management plan	 289
Figure ‎13-7: Example of EA management scope	 289
Figure ‎13-8: Example for EA management plan process	 290
Figure ‎13-9: Example for EA management plan principles	 290
Figure ‎13-10: Example for EA roles for large organization	 292
Figure ‎13-11: Example for architect tasks	 292
Figure ‎13-12: Example for EA update process	 294
Figure ‎13-13: Example for EA change process	 295
Figure ‎13-14: Example for EA diffusion process	 295
Figure ‎13-15: Example for EA compliance review	 296
Figure ‎13-16: Example for EA design exception process	 296
Figure ‎13-17: Example for EA system design	 297
Figure ‎14-1: Example for EA usage guideline	 302
Figure ‎14-2: NEA System Context	 322
Figure ‎14-3: NEA Meta-Model	 324
Figure ‎14-4: Components of Strategic Management in government agency	 338
Figure ‎14-5: Linking strategy and e-Government transformation	 340
Figure ‎14-6: Relevant artifacts for e-Government Transformation Plan	 342
Figure ‎14-7: NEA EA maturity model	 345
13
National Overall Reference Architecture (NORA) – Handbook
List of Tables
Table ‎2-1: List of NEA Framework Components	 27
Table ‎2-1: Common EA objectives / drivers	 29
Table ‎3-1: Stage 1 steps	 37
Table ‎3-2: EA value proposition to stakeholders	 39
Table ‎3-3: Likely EA value proposition based on e-Transformation maturity	 42
Table ‎3-4: Local examples for EA drivers or purposes	 43
Table ‎3-5: Considerations for EA project strategy development	 45
Table ‎4-1: Stage 2 steps	 49
Table ‎4-2: Typical government EA committees and working teams	 50
Table ‎4-3: Governance / Management fields	 52
Table ‎4-4: Examples of governance / management fields in government agencies	 53
Table ‎4-5: Examples of EA scope	 55
Table ‎4-6: Examples of EA gradual scoping	 56
Table ‎4-7: Development approach recommendations	 57
Table ‎4-8: Budget categories for consideration	 58
Table ‎4-9: Description on the EA usefulness	 60
Table ‎4-10: Examples of EA usefulness categories	 61
Table ‎4-11: Examples of EA usefulness	 62
Table ‎5-1: Continuous governance steps	 69
Table ‎5-2: Need for EA change management	 72
Table ‎5-3: EA awareness methods	 74
Table ‎5-4: Suggested content for EA awareness	 76
Table ‎5-5: EA promotion activities	 78
Table ‎5-6: Capabilities required in EA	 81
Table ‎5-7: Activities to define EA usage plan	 83
Table ‎5-8: Activities to define EA management plan	 84
Table ‎5-9: Performance metrics example	 86
Table ‎6-1: Stage 3 steps	 89
Table ‎6-2: Example questionnaire	 91
Table ‎6-3: Example format to gather EA requirements	 92
14
National Overall Reference Architecture (NORA) – Handbook
Table ‎6-4: Internal analysis areas & expected outcomes	 93
Table ‎6-5: SWOT chart template	 101
Table ‎7-1: Stage 4 steps	 105
Table ‎7-2: Considerations for effective Vision & Mission statements	 108
Table ‎7-3: Criteria examples of good architecture principles	 109
Table ‎7-4: Examples of research areas for EA Framework	 112
Table ‎7-5: Description of EA elements	 114
Table ‎7-6: Activities to develop the EA Model	 115
Table ‎7-7: EA Model view by stakeholders	 116
Table ‎7-8: EA Model view by architecture	 116
Table ‎7-9: Example of Yesser’s standard terms	 120
Table ‎8-1: Differences between Reference Models and Architectures	 125
Table ‎8-2: Summary of artifacts by reference models and architectures	 129
Table ‎9-1: Stage 5 steps	 136
Table ‎9-2: PRM artifact descriptions	 138
Table ‎9-3: Main activities to build agency PRM	 139
Table ‎9-4: Example measurement areas, categories and indicators	 141
Table ‎9-5: BRM artifact descriptions	 144
Table ‎9-6: Main activities to build agency BRM	 145
Table ‎9-7: Example of business area, LoB, business function and sub-business functions	 148
Table ‎9-8: ARM artifact descriptions	 150
Table ‎9-9: Main activities to build agency ARM	 153
Table ‎9-10: NEA ARM principles	 154
Table ‎9-11: DRM artifact descriptions	 158
Table ‎9-12: Main activities to build agency DRM	 160
Table ‎9-13: Example data structure definition	 163
Table ‎9-14: Example data exchange definition	 163
Table ‎9-15: TRM artifact descriptions	 165
Table ‎9-16: TRM service area and category descriptions	 166
Table ‎9-17: Main activities to build agency TRM	 167
Table ‎10-1: Stage 6 steps	 175
15
National Overall Reference Architecture (NORA) – Handbook
Table ‎10-2: Example of possible data sources	 177
Table ‎10-3: BA relationship with other architectures	 180
Table ‎10-4: BA artifact descriptions	 182
Table ‎10-5: Activities to build BA	 182
Table ‎10-6: The properties of organization chart	 185
Table ‎10-7: Example of sub-business function description	 189
Table ‎10-8: Business process description example	 190
Table ‎10-9: Business activity description example	 191
Table ‎10-10: The properties of service catalogue	 193
Table ‎10-11: Service catalogue example	 194
Table ‎10-12: AA relationship with other architectures	 196
Table ‎10-13: AA artifact descriptions	 198
Table ‎10-14: Activities to build AA	 198
Table ‎10-15: The properties of application overview	 199
Table ‎10-16: The properties of application catalogue	 201
Table ‎10-17: Application catalogue example	 202
Table ‎10-18: The properties of application function	 203
Table ‎10-19: Application function example	 204
Table ‎10-20: The properties of application relationship	 206
Table ‎10-21: Application relationship example	 207
Table ‎10-22: DA relationship with other architectures	 209
Table ‎10-23: DA artifact descriptions	 211
Table ‎10-24: Activities to build DA	 211
Table ‎10-25: The properties of conceptual data model	 212
Table ‎10-26: The properties of logical data model	 213
Table ‎10-27: The properties of data flow diagram	 215
Table ‎10-28: The properties of database portfolio catalogue	 216
Table ‎10-29: Database catalogue example	 217
Table ‎10-30: The properties of data dictionary	 218
Table ‎10-31: Data dictionary example	 219
Table ‎10-32: TA relationship with other architectures	 221
16
National Overall Reference Architecture (NORA) – Handbook
Table ‎10-33: TA artifact descriptions	 223
Table ‎10-34: Activities to build TA	 223
Table ‎10-35: The properties of infrastructure descriptions	 226
Table ‎10-36: The properties of hardware catalogue	 233
Table ‎10-37: Hardware catalogue example	 234
Table ‎10-38: The properties of software catalogue	 235
Table ‎10-39: Software catalogue example	 236
Table ‎10-40: Activities to analyze current architectures	 237
Table ‎11-1: Stage 7 steps	 248
Table ‎11-2: Activities for defining target architecture directions	 249
Table ‎11-3: Target BA artifact descriptions	 252
Table ‎11-4: Activities to build target BA	 253
Table ‎11-5: Target AA artifact descriptions	 256
Table ‎11-6: Activities to build target AA	 257
Table ‎11-7: Target DA artifact descriptions	 260
Table ‎11-8: Activities to build target DA	 261
Table ‎11-9: Target TA artifact descriptions	 264
Table ‎11-10: Activities to build target TA	 265
Table ‎12-1: Stage 8 steps	 270
Table ‎12-2: Activities to define transition projects	 270
Table ‎12-3: Activities to prioritize transition projects	 272
Table ‎12-4: Activities to create transition roadmap	 274
Table ‎12-5: Activities for estimating resources and outcomes	 276
Table ‎13-1: Stage 9 steps	 282
Table ‎13-2: Activities to define EA usage purpose & scope	 283
Table ‎13-3: Activities to define usage plan development	 285
Table ‎13-4: Example for EA users	 286
Table ‎13-5: Activities of EA management purposes & scope	 288
Table ‎13-6: Activities to develop EA management organization	 191
Table ‎13-7: Activities to define EA management process	 293
Table ‎13-8: Activities to define EA management system	 297
17
National Overall Reference Architecture (NORA) – Handbook
Table ‎13-9: Example for EA management system’s functions	 298
Table ‎14-1: Stage 10 steps	 301
Table ‎14-2: Example for EA management guideline	 303
Table ‎14-3: Example for EA usage & management plan assessment	 304
Table ‎14-4: Stage 1 summary	 307
Table ‎14-5: Stage 1 steps	 308
Table ‎14-6: Stage 2 summary	 309
Table ‎14-7: Stage 2 steps	 309
Table ‎14-8: Continuous governance summary	 310
Table ‎14-9: Continuous governance steps	 310
Table ‎14-10: Stage 3 summary	 311
Table ‎14-11: Stage 3 steps	 311
Table ‎14-12: Stage 4 summary	 312
Table ‎14-13: Stage 4 steps	 313
Table ‎14-14: Stage 5 summary	 314
Table ‎14-15: Stage 5 steps	 315
Table ‎14-16: Stage 6 summary	 316
Table ‎14-17: Stage 6 steps	 316
Table ‎14-18: Stage 7 summary	 317
Table ‎14-19: Stage 7 steps	 317
Table ‎14-20: Stage 8 summary	 318
Table ‎14-21: Stage 8 steps	 318
Table ‎14-22: Stage 9 summary	 319
Table ‎14-23: Stage 9 steps	 319
Table ‎14-24: Stage 10 summary	 319
Table ‎14-25: Stage 10 steps	 320
Table ‎14-26: NEA Meta-Classes	 326
Table ‎14-27: NEA business service Meta-Class	 335
Table ‎14-28: List of artifacts for e-Government Transformation Plan	 343
Table ‎14-29: EA maturity components & levels	 346
Table ‎14-30: Attributes of business service (Arabic & English)	 348
18
National Overall Reference Architecture (NORA) – Handbook
1.Introduction
19
National Overall Reference Architecture (NORA) – Handbook
1. Introduction
1.1 Document purpose
The purpose of this document is to describe and elaborate the National Overall Reference
Architecture (NORA) that will be used as a guide for government agencies to develop their
own Enterprise Architecture (EA). This document also describes, to some extent, how NORA
is link to the overall National Enterprise Architecture (NEA) Framework.
1.2 National Enterprise Architecture Framework
The National Enterprise Architecture (NEA) Framework is a key element for the national e-Government
envisioned to incorporate a federate approach to enterprise architecture for the Kingdom of
Saudi Arabia (KSA). NEA Framework supports the identification of re-usable components and
services, and facilitates a basis for Information Technology (IT) investment optimization. In
addition, NEA enables more cost-effective and timely delivery of e-services through a repository
of standards, principles and reference models that assist in the design and delivery of business
services to citizens, residents, commercial establishments and inter-government collaboration.
1.3 Values of NORA
Government agencies who do not have an EA in practice would typically face the following problems:
1.	 Lack of standardization of business services, data and IT interoperability within the government
agency and across government agencies
2.	Lack of performance indicator in IT investment linking to the business objectives
3.	Government business ownerships are unclear
4.	Lack of whole of government agency view
5.	Duplicated IT systems, data and IT infrastructure within a government agency is common
6.	Misalignment between government agency’s business services and IT initiatives
7.	 Lack of standards to integrate services, business processes, IT systems, data and IT infrastructure
8.	No performance indicators for business function and services
9.	Lack of quality checks for delivering IT systems, data and infrastructure
20
National Overall Reference Architecture (NORA) – Handbook
10.	 Lack of integrated government services and consistent delivery.
11.	 With EA, the above problems can be eradicated. However, the development and implementation
of an EA is not an easy task and government agencies can face the following challenges:
12.	 EA stakeholders’ low awareness on EA, its benefits and its practices
13.	 Little knowledge of EA building process
14.	 Communication barriers and bottlenecks among EA stakeholders
15.	 Implementing EA without a systematic approach
16.	 Experiencing difficulty in maintaining EA practices
17.	 Excessive reliance on vendors and external expertise.
1.4 Goals of NORA
The goals of NORA are as follows:
1.	 Define scope and requirements of the EA at the government agencies
2.	 Help government agencies to have a smooth and effective EA implementation
3.	 Ensure quality of government agency’s EA through systematic processes and recommendations
4.	 Alignment of agency’s EA with Saudi government national architecture and National Action Plans
to facilitate whole of government approach
5.	 Facilitate EA utilization, promotion and capability building in the government agencies.
21
National Overall Reference Architecture (NORA) – Handbook
1.5 Features of NORA
The main features of NORA are:
1.	 As  a guide for EA development, it is written from the government agencies’ perspective
2.	 All stages in the EA lifecycle are described to some detail to provide clarity to the government
agencies
3.	 Balanced approach in EA development that focuses both on processes and the production of
standard artifacts or deliverables
4.	 Examples and example outputs are provided to aid understanding
5.	 Highly customizable to suit varied requirements of different government agencies.
1.6 Target audience
As NORA is a guide for government agencies to develop their EAs, the target audience for NORA
are as follows:
1.	 Enterprise Architects
2.	 Business Architects
3.	 Application Architects
4.	 Data Architects
5.	 Technology Architects
6.	 IT Architects
7.	 CIOs
8.	 CXOs
9.	 Project Managers
10.	 Business Owners
11.	 IT System Owners
12.	 IT Managers
13.	 Project Managers
14.	 IT Consultants
15.	 IT Vendors.
22
National Overall Reference Architecture (NORA) – Handbook
1.7 Document structure
NORA contains the following sections:
1.	Executive Summary
2.	The executive summary gives a complete summary of NORA. After reading this section, the
reader can understand how NORA guides the government agencies in the EA development.
The executive summary is excellent for government agencies’ decision makers. All staff
involve in EA should also read this executive summary.
3.	Stages of EA Development
4.	This document provides the detailed description by stages. The detailed process and expected
EA deliverables are explain in each stage. Examples and templates are also provided where
possible.
5.	Annex
The annexes provide additional templates, checklists and information.
1.8 Related information
As NORA is only one of the many documents, it is advisable to refer to the main NEA Framework.
1.9 Contact information
For any feedback, comments or need for more information on NORA, please email to
nea@yesser.gov.sa
23
National Overall Reference Architecture (NORA) – Handbook
2.Executive
Summary
24
National Overall Reference Architecture (NORA) – Handbook
2. Executive Summary
2.1 Need for Enterprise Architecture
Gartner Research defines enterprise architecture as:
“Enterprise Architecture (EA) is a discipline for proactively and holistically leading enterprise
(i.e. government) responses to disruptive forces by identifying and analyzing the execution of
change toward desired business vision and outcomes.
EA delivers value by presenting business and IT leaders with signature-ready recommendations
for adjusting policies and projects to achieve target business outcomes that capitalize on relevant
business disruptions.”
Government agencies have to respond to continuous disruptive forces such as economic
changes, social demands, political directions and technology advancements. The government
agencies’ responses to these disruptive forces are on their own silo actions. While government
agencies have made their best effort to derive their own desired outcomes, the end result
to the stakeholders such as citizens, businesses and government leaders are far from real
satisfaction.
With EA, on the other hand, the execution of change is a structured approach with the various
perspectives on the government business, desired outcomes, availability of technologies and
processes. When EA is correctly implemented, it provides the following valuable benefits to key
decision makers:
•	 Insight – the abstraction of knowledge based on detailed information including issues, challenges
and opportunities
•	 Oversight – the information overview corresponding to the overall accountabilities and
responsibilities of the government agencies, and for the whole-of-government
•	 Foresight – from the analysis of detailed data from various sources, trend analysis and event
probabilities can be calculated and estimated.
25
National Overall Reference Architecture (NORA) – Handbook

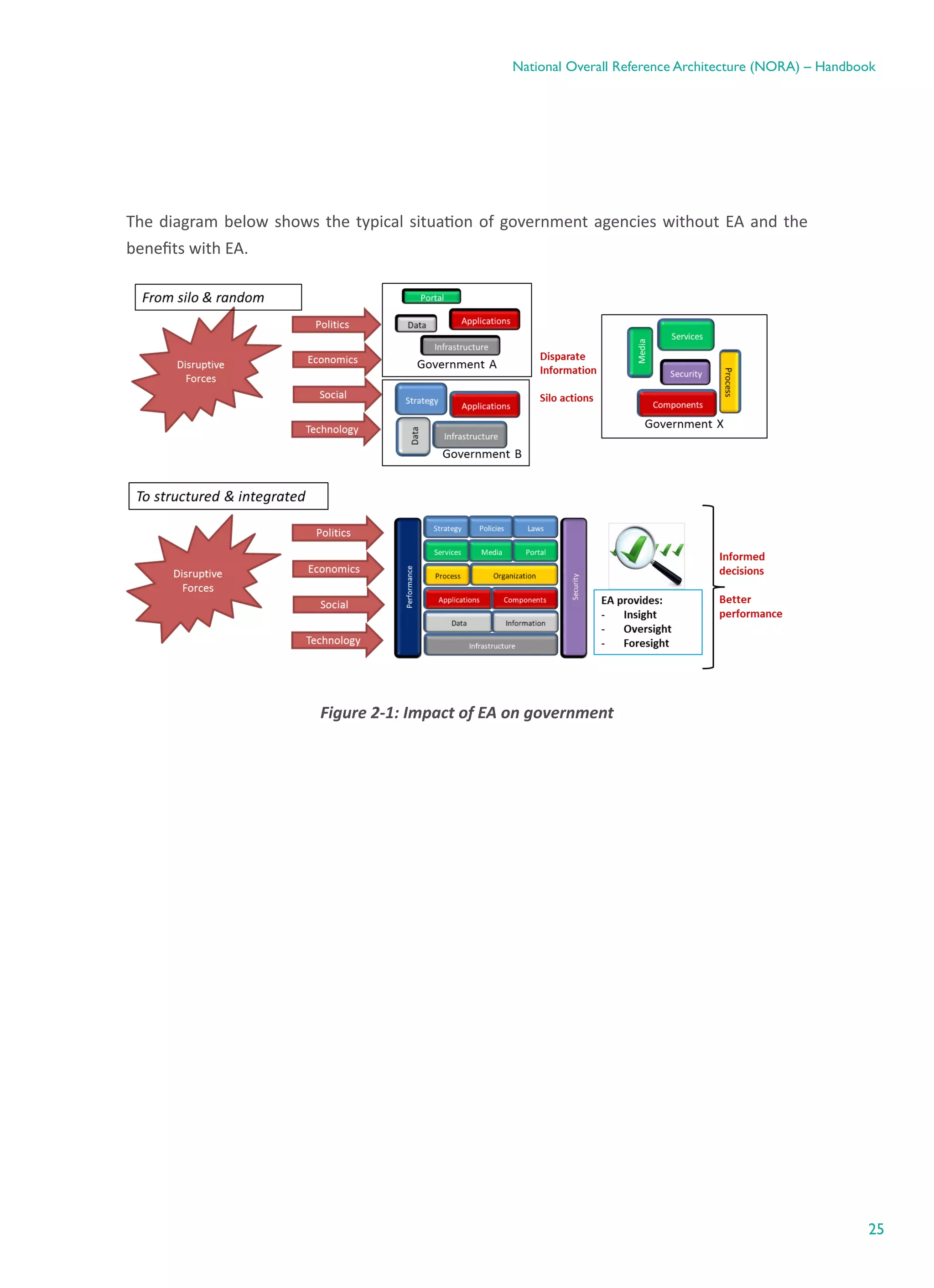

The diagram below shows the typical situation of government agencies without EA and the
benefits with EA.
Figure ‎2-1: Impact of EA on government
26
National Overall Reference Architecture (NORA) – Handbook
2.2 Background of NEA Framework
The NEA Framework is the window for strategic integration and collaboration of an effective na-
tional e-government implementation. NEA is the enterprise architecture for the whole-of-Saudi
government. Together with other strategies such as the Saudi e-Government Action Plan, the
NEA Framework and its components allow useful insight and foresight for the future development
and implementation of highly integrated e-government and e-services.
The NEA Framework has 11 main architecture components as depicted in the diagram below.
Each architecture component has a specific role and function. In addition, each architecture
component may have direct or indirect relationship(s) with other architecture components.
The table below provides a summary list of all the 11 architecture components. Please refer to
separate documents for detailed information of the architecture components.
Figure ‎2-2: NEA Framework
27
National Overall Reference Architecture (NORA) – Handbook
Compo-
nent Name
Component Description
Strategy The strategy component of NEA Framework captures the essences of strategic
alignment with National and e-government strategic plans. The constituents of
the strategic component takes cognizance of the envisioned future as per the
above plans, and aligns itself strategically by producing long term and short term
plans to meet that future vision. The Journey being guided by adequate policies.
Models The NEA Models are a high-level classification of views , key architectural elements
and the best practice for them. They facilitate in forming standardized viewpoints
for example from a snapshot of the whole of government to  Performance, Business,
Application, Data, Technology, Security, Maturity  etc..
Operation The operation is about managing the day to day business of NEA, that primarily
involves designing, and controlling the process of service delivery and redesigning
business operations in delivering services. It is guided by well-defined processes,
methodology and tools that ensure business operations are efficient and effective in
terms of meeting customer requirements.
Governance NEA governance is about providing the strategic directions to achieve the NEA
vision, mission and objectives through agile organization structure, clear roles
and responsibilities, and effective set of governance or management practices. It
is also about regular monitoring and reviewing of progress while understanding the
constant changes in economic, social and technological environments
Table ‎2-1: List of NEA Framework Components
NORA is one of the integral parts of NEA Framework.  NORA’s role within the NEA Framework
is to provide a definitive and clear methodology for building EA in the government agencies.
28
National Overall Reference Architecture (NORA) – Handbook
2.3 Objectives of NORA
The objectives of NORA are as follows:
1.	 To guide government agencies in their development of EAs
2.	 To speed up EA development with quality outputs
3.	 To ensure EA in government agencies are aligned with their e-Government transformation
and IT plans.
2.4 Defining a purpose for agency EA
In alignment to the strategic 2nd Saudi e-Government Action Plan, every government agency is
expected to have an e-transformation roadmap that would pave the way for advancement of
delivering government services. EA is an excellent tool for planning as well as implementing this
e-transformation roadmap.
Although the ultimate goal is to transform their government services and business functions,
government agencies have to find and determine the most important driver or motivation to
develop their very own EA. The following table lists the common drivers and the corresponding
objectives to develop EA. These common scenarios will influence the use of NORA as a guideline
to develop EA for agencies.
29
National Overall Reference Architecture (NORA) – Handbook
Drivers EA Objectives - Values

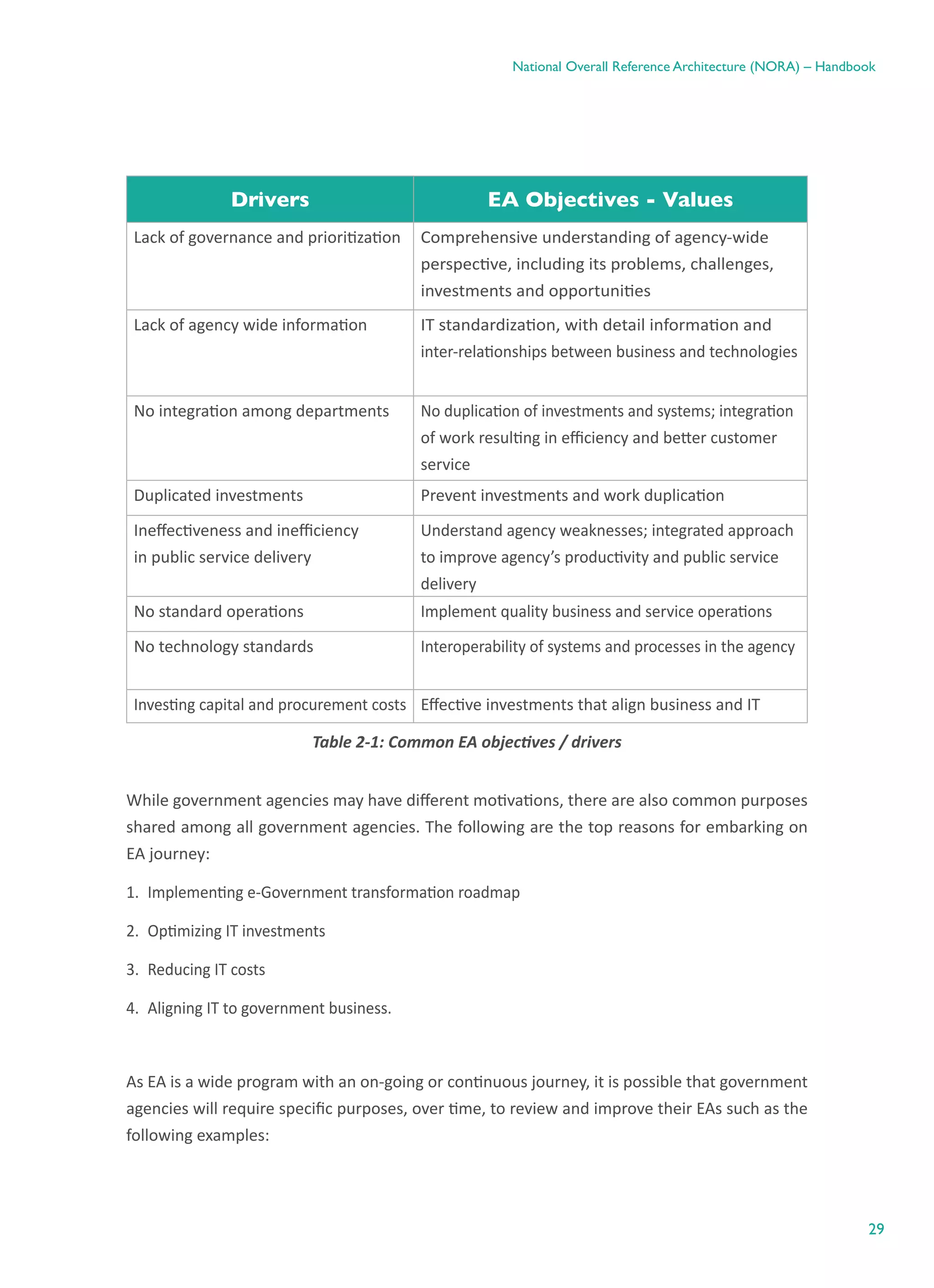

Lack of governance and prioritization Comprehensive understanding of agency-wide
perspective, including its problems, challenges,
investments and opportunities
Lack of agency wide information IT standardization, with detail information and
inter-relationships between business and technologies
No integration among departments No duplication of investments and systems; integration
of work resulting in efficiency and better customer
service
Duplicated investments Prevent investments and work duplication
Ineffectiveness and inefficiency
in public service delivery
Understand agency weaknesses; integrated approach
to improve agency’s productivity and public service
delivery
No standard operations Implement quality business and service operations
No technology standards Interoperability of systems and processes in the agency
Investing capital and procurement costs Effective investments that align business and IT
Table ‎2-1: Common EA objectives / drivers
While government agencies may have different motivations, there are also common purposes
shared among all government agencies. The following are the top reasons for embarking on
EA journey:
1.	 Implementing e-Government transformation roadmap
2.	 Optimizing IT investments
3.	 Reducing IT costs
4.	 Aligning IT to government business.
As EA is a wide program with an on-going or continuous journey, it is possible that government
agencies will require specific purposes, over time, to review and improve their EAs such as the
following examples:
30
National Overall Reference Architecture (NORA) – Handbook
Standardization and interoperability of services, IT applications, data and infrastructure
Selection and/or prioritization of projects in the government agency for funding and implementation
1.	Building new capability such as improving customer service, making business processes
effective, and agency-wide adoption of mobile applications and devices
2.	Improve and integrate business critical government services and business functions through
Business Process Re-Engineering and automation
3.	Development of IT Resource Management and IT Portfolio Management.

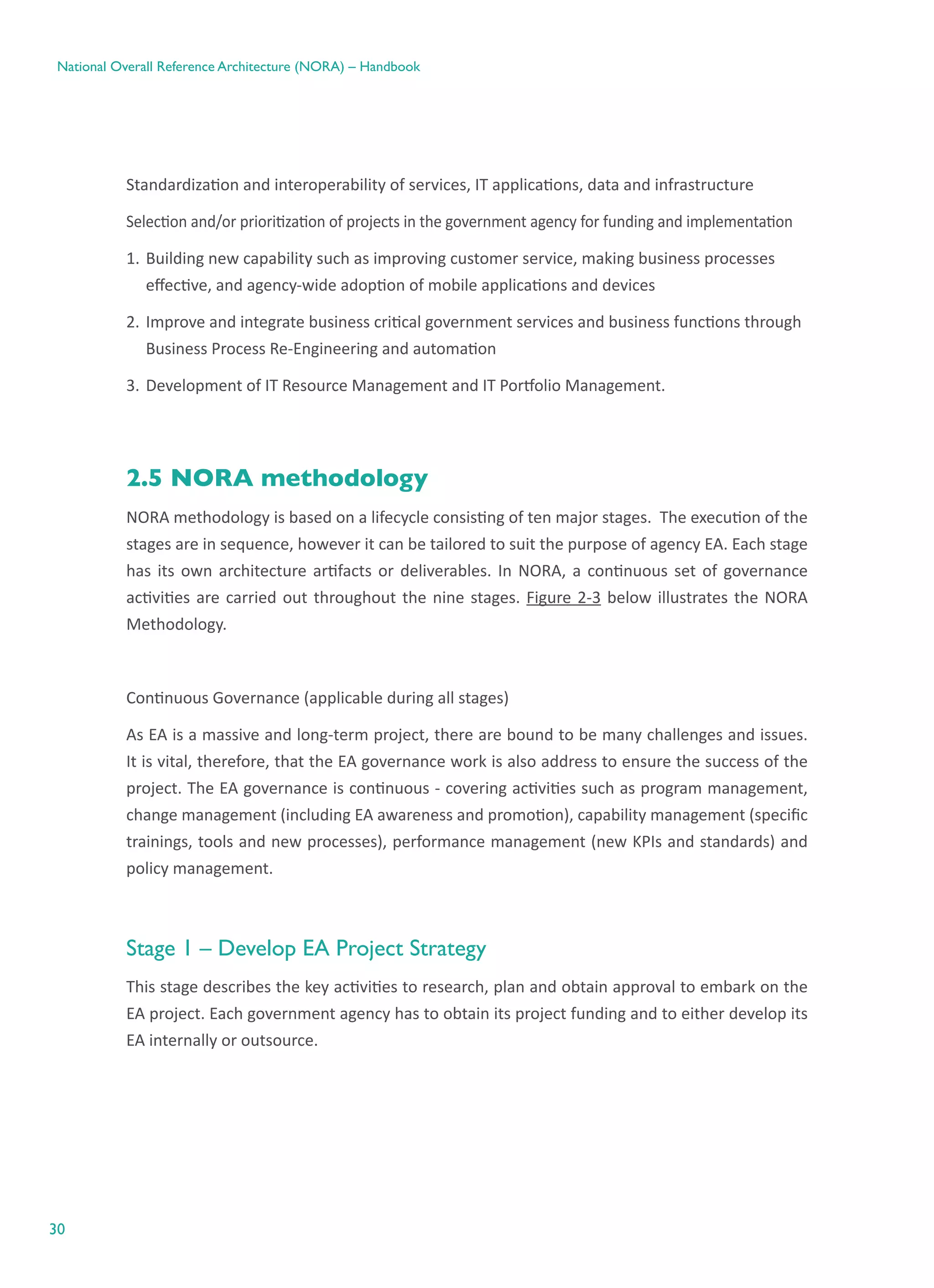

2.5 NORA methodology
NORA methodology is based on a lifecycle consisting of ten major stages.  The execution of the
stages are in sequence, however it can be tailored to suit the purpose of agency EA. Each stage
has its own architecture artifacts or deliverables. In NORA, a continuous set of governance
activities are carried out throughout the nine stages. Figure 2-3 below illustrates the NORA
Methodology.
Continuous Governance (applicable during all stages)
As EA is a massive and long-term project, there are bound to be many challenges and issues.
It is vital, therefore, that the EA governance work is also address to ensure the success of the
project. The EA governance is continuous - covering activities such as program management,
change management (including EA awareness and promotion), capability management (specific
trainings, tools and new processes), performance management (new KPIs and standards) and
policy management.
Stage 1 – Develop EA Project Strategy
This stage describes the key activities to research, plan and obtain approval to embark on the
EA project. Each government agency has to obtain its project funding and to either develop its
EA internally or outsource.
31
National Overall Reference Architecture (NORA) – Handbook
Stage 2 – Develop EA Project Plan
Having established an approved EA Project Strategy, the government agency has to carry out
the detailed plan for the EA project. This stage describes the key activities involved in developing
and obtaining approval for the EA project.
Stage 3 – Analyze Current State
With the approved EA project plan in place, the government agency can start the actual work
by analyzing its current state – both in terms of business and IT. This stage describes the key
activities in reviewing and analyzing the different aspects of the current state of the government
agency.
Stage 4 – Develop EA Framework
This is the stage where a government agency starts to develop its EA. In this stage, the government
agency constructs the main pillars such as EA vision & mission, architecture goals & principles,
EA Framework, taxonomy, and other related standards that is fundamental to its EA journey.
The government agency should focus on building quality EA framework and other relevant
processes.
Stage 5 – Build Reference Models
Based on the EA framework developed previously, this stage is all about building the reference
models so that a government agency can have standard views and taxonomies of key organizational
assets and processes such as business, application, data and technology domains.
Stage 6 – Build Current Architectures
The focus of this stage is in capturing the current architectures of the government agency so
that the agency can clearly understand its IT and business landscapes. This would allow a better
visibility of the interconnections among different architectures and components, and aid in
analyzing the agency’s issues, challenges and opportunities relating to business, information/
data and technologies.
32
National Overall Reference Architecture (NORA) – Handbook

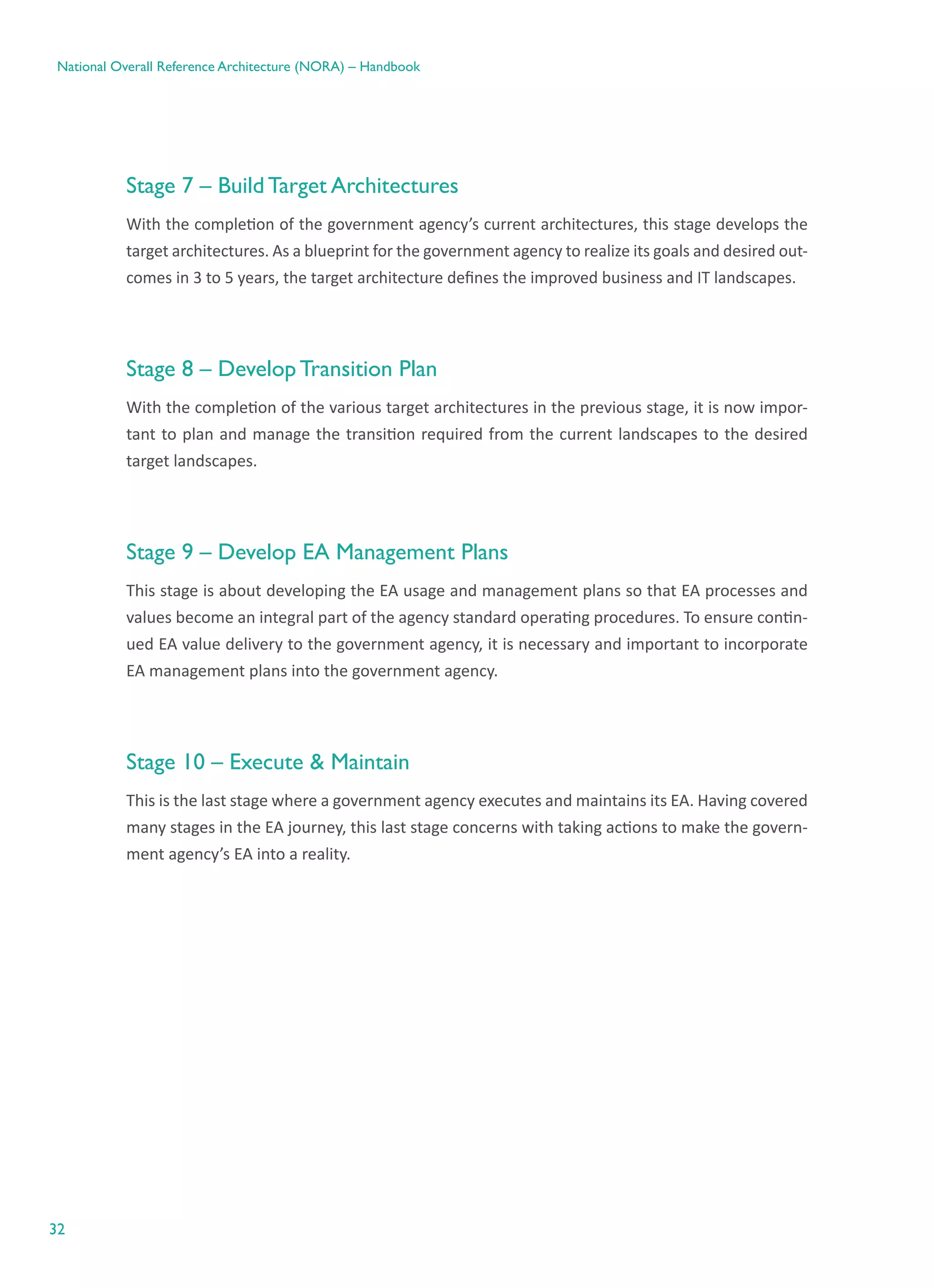

Stage 7 – Build Target Architectures
With the completion of the government agency’s current architectures, this stage develops the
target architectures. As a blueprint for the government agency to realize its goals and desired out-
comes in 3 to 5 years, the target architecture defines the improved business and IT landscapes.
Stage 8 – Develop Transition Plan
With the completion of the various target architectures in the previous stage, it is now impor-
tant to plan and manage the transition required from the current landscapes to the desired
target landscapes.
Stage 9 – Develop EA Management Plans
This stage is about developing the EA usage and management plans so that EA processes and
values become an integral part of the agency standard operating procedures. To ensure contin-
ued EA value delivery to the government agency, it is necessary and important to incorporate
EA management plans into the government agency.
Stage 10 – Execute & Maintain
This is the last stage where a government agency executes and maintains its EA. Having covered
many stages in the EA journey, this last stage concerns with taking actions to make the govern-
ment agency’s EA into a reality.
33
National Overall Reference Architecture (NORA) – Handbook
Figure ‎2-3: NORA Methodology
Please also refer to Annex A – Summary of NORA Deliverables by Stages that acts as a checklist
for government agencies in their EA development.
34
National Overall Reference Architecture (NORA) – Handbook
2.6 NORA relationship to NEA Framework
Although NORA is only a guide for government agencies to develop their EAs, it is nonetheless
an important methodology. When government agencies develop their EAs according to NORA,
not only do they deliver their own EAs, but also it ensures that all EA development complies
with the overall NEA Framework.
NORA allows government agencies to comply with and align to the national e-Government
transformation plan and initiatives. Through NORA, government agencies can review and develop
detailed reference models – each aligned with the NEA Framework’s reference models such as
Business Reference Model, Application Reference Model, Data Reference Model and Technology
Reference Model. When the various reference models are aligned, it aids government agencies
to share applications and information, and to develop highly integrated business functions and
services that delight citizens and businesses.
35
National Overall Reference Architecture (NORA) – Handbook
3.Stage1-Develop
EAProjectStrategy
36
National Overall Reference Architecture (NORA) – Handbook
3. Stage 1 - Develop EA
Project Strategy
3.1 Stage summary
This stage describes the key activities to research, plan and obtain approval to embark on the
EA project. Each government agency has to obtain its project funding and to either develop its
EA internally or outsource.
3.2 Stage purpose
Lay the foundation of a government agency’s EA implementation journey with clear directions
and commitments. The following specific expected outcomes from this stage are:
1.	 Increase the government agency’s EA awareness – from top management to the operations staff
2.	 Define and communicate EA goals and directions
3.	 Obtain management approval to embark on the EA journey.
3.3 Stage initiation
Yesser will communicate with the e-Transformation Committee in each government agency to
initiate the agency EA implementation. Government agencies can also request and discuss with
Yesser to initiate their EA program.
3.4 Key steps in stage 1
Preparation is an important stage that requires diligent research and planning. This is the first
major step to embark EA in the government agency. The key activities and expected deliver-
ables in Stage 1 are shown in Table 3-1:
37
National Overall Reference Architecture (NORA) – Handbook
Stage /
Step No
Description Deliverable

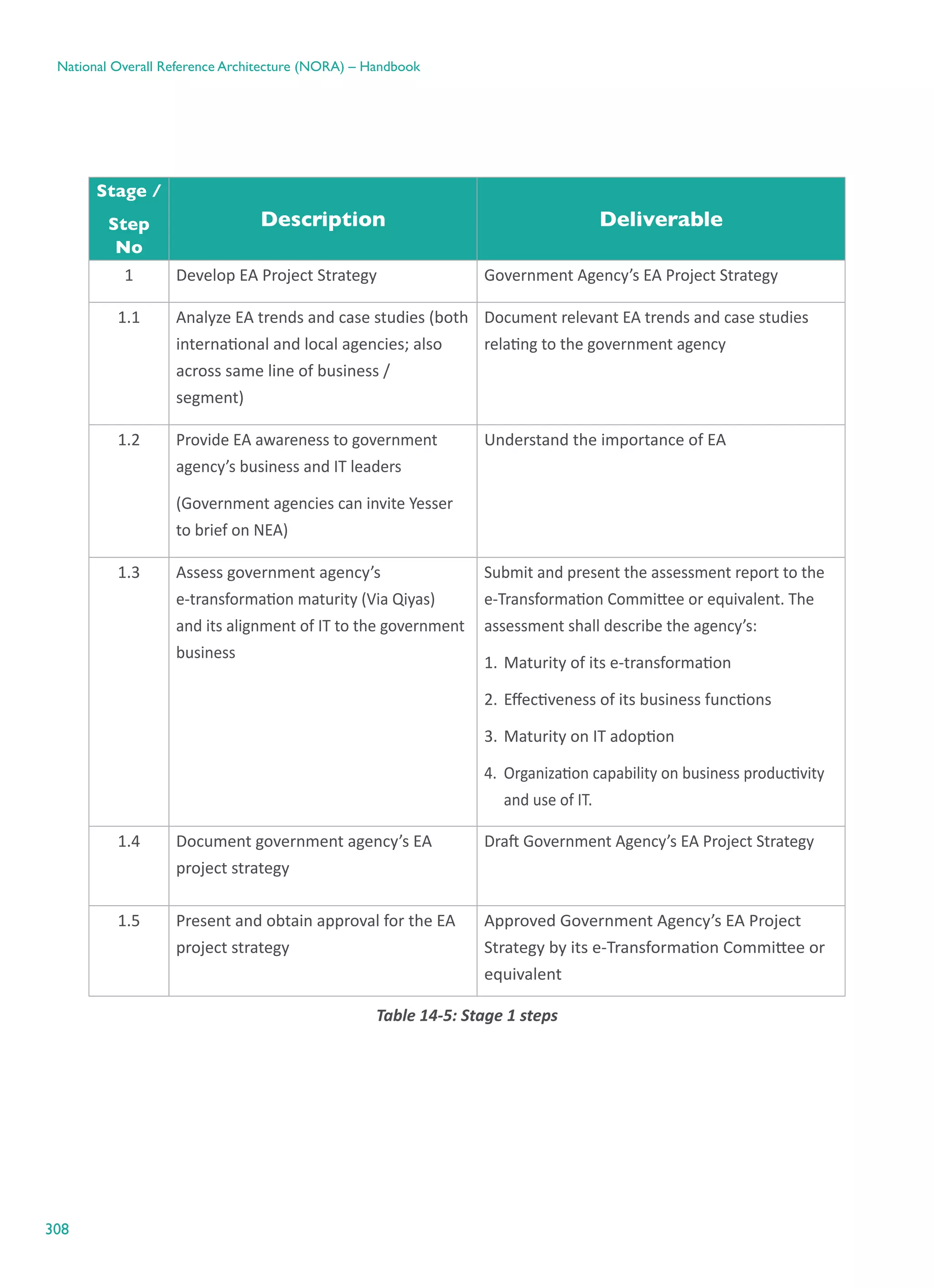

1 Develop EA Project Strategy Government Agency’s EA Project Strategy
1.1 Analyze EA trends and case studies (both
international and local agencies; also
across same line of business/Business
function in BRM )
Document relevant EA trends and case studies
relating to the government agency
1.2 Provide EA awareness to government
agency’s business and IT leaders
(Government agencies can invite Yesser to
brief on NEA)
Understand the importance of EA
1.3 Assess government agency’s e-transformation
maturity(Via Qiyas) and its alignment of IT
to the government business
Submit and present the assessment report to
the e-Transformation Committee or equivalent.
The assessment shall describe the agency’s:
1.	Maturity of its e-transformation
2.	Effectiveness of its business functions
3.	Maturity on IT adoption
4.	Agency’s capability on business productivity
and use of IT.
1.4 Document government agency’s EA project
strategy
Draft Government Agency’s EA Project Strategy
1.5 Present and obtain approval for the EA
project strategy
Approved Government Agency’s EA Project
Strategy by its e-Transformation Committee or
equivalent
Table ‎31: Stage 1 steps
38
National Overall Reference Architecture (NORA) – Handbook
3.4.1 Step 1.1 Analyze EA trends and case studies
As stated by International Benchmarking Clearinghouse (IBC), analyzing EA trends is a set of
“Activities to continuously evaluate and compare world’s leading corporations or agencies with
a current organization to improve the organization’s performance”.
This activity is vital for the agency implementing EA, in terms of understanding the best practices
adopted by similar verticals. To leverage their learning, choose the most applicable strategy
for the agency. However if the agency finds itself in a difficult position either to execute it, or if
there is a possibility of this effort forking into a new project and hence impede the EA strategy
development. Then, they may choose to limit the scope of the activity to reduce negative impact
on the EA Project.
While there are numerous ways to carry out this step, the following activities are recommended:
1.	Form a small team of members (both IT and non-IT) who are interested and passionate
about EA
2.	Understand the basics of EA by attending seminars or trainings
3.	Carry out a high level research on the current trends in EA. Examples of reliable online
resources include Federal Enterprise Architecture (FEA), The Open Group Architecture
Framework (TOGAF), National Association of State Chief Information Officers (NASCIO) and
Enterprise Architecture Center of Excellence (EACOE). There are also numerous articles on
‘EA Trends in Government’ (simply search on the Internet for the latest)
4.	Refer to more detailed EA case studies for similar line of business or government domain
such as Education, Health, Agriculture, Oil & Gas (Energy) and Municipality
5.	Document the findings and find basic patterns in EA development
6.	Refer to the Yesser’s National Enterprise Architecture (NEA) Framework. They can also discuss
with Yesser’s NEA Office for details and to find other relevant government agencies who have
embarked or completed their EAs
7.	Finalize the EA analysis document.
39
National Overall Reference Architecture (NORA) – Handbook
3.4.2 Step 1.2 Provide EA awareness
Having documented the EA trends and case studies that are relevant to the government agency,
the next step is to spread the importance of EA. The idea is to provide constant awareness to all
levels of staff in the government agency – both the business and IT staff, including top management
and the operations staff.
In particular, provide the EA awareness to the top management or e-Transformation Committee.
This is important as they will be the main decision makers and sponsor for the EA project.
Government agency can also work with Yesser to present EA as a strategic enabler in
e-Government to them. The recommended EA value propositions are listed in Table 3-2:

S/No Stakeholder EA Value Proposition
1 Top Management (Minister, Di-
rector-General, CEO, CXO) and /
or e-Transformation Committee
1.	Align government agency projects with Vision 2030,
National Transformation Plan and Saudi e-Government
Action Plan
2.	Aid planning and prioritizing government agency-wide
action plan
3.	Improve service quality to citizens and businesses
4.	Prioritize and improve IT investments for government
agency
5.	Business and technology innovation to deliver highly
integrated, value-added services.
2 Finance Director / CFO 1.	Reduce wastage of IT costs
2.	Prioritize and improve IT investments for government
agency.
3 Business Owners 1.	Improve service quality to citizens and businesses
2.	Increase productivity
3.	Integrate work across business domains or divisions,
including inter-agency.
4 IT Director / CIO 1.	Prioritize IT projects
2.	Reduce wastage of IT costs
3.	Identify consolidation projects to reduce IT cost and
better management
4.	Develop inter-operability standards within govern-
ment agency and inter-agency.
Table ‎32: EA value proposition to stakeholders
40
National Overall Reference Architecture (NORA) – Handbook
In addition to the EA Value Proposition, the team can also provide EA awareness on factors
such as:
a.	 Explain best EA practices in other agencies.
b.	 Explain EA related laws and regulations imposed on government agencies via decrees .
c.	 Explain how EA affects agency’s performance and innovation endeavors, and what EA will
bring to the agency’s executives.
d.	 Utilize external expertise as needed.
It is recommended that the team present the EA value proposition to the IT Director or CIO
first. Subsequently, the team can present or provide awareness to the different stakeholders
and obtain feedback from them. Finally, they can present to the top management to get their
buy-in. The government agency can also approach Yesser’s NEA office to help in the EA awareness
sessions.
For now, the awareness sessions are to make the stakeholders think about the value of EA. It is
not to get their approval yet (although it would be good). Once they are aware of the benefits
of EA, the team may also need to engage them for the next step. Note that these awareness
sessions are part of the continuous EA governance (see the ‘Continuous Governance’ section
for details).
3.4.3 Step 1.3 Assess government agency’s e-transformation maturity
This step focuses on the maturity of the government agency’s e-transformation. From the
above value propositions, EA can help to determine areas for improvements to increase the
e-transformation maturity. The e-Transformation maturity is measured yearly by Yesser using
the Qiyas tool. The outcome of this step will drive the actual scope and motivation for the
government agency’s EA. The following activities are recommended:
41
National Overall Reference Architecture (NORA) – Handbook
1.	Obtain the government agency’s maturity report from Yesser via Qiyas
2.	Factors for consideration include rate of IT adoption, effectiveness of business services &
functions, satisfaction level of citizens & businesses, rate of alignment with 2nd Saudi
e-Government Action Plan, government agency’s capability on business productivity, and
the extent of sharing of applications, data and IT infrastructure within the government
agency and inter-agency
3.	Identify the areas for improvements
4.	Analyze these areas and map to the specific EA value propositions
5.	Also refer to NEA Maturity Model so that the government agency can further assess its
maturity
6.	Shortlist the recommended EA value proposition(s)
7.	 Present to the e-Transformation Committee or equivalent and get their approval or concurrence.
From their feedback, may need to do changes to finalize the EA value proposition.
Table 3-3 provides a summary of the likely EA value propositions based on the e-transformation
maturity level. Note that this is only an indication. Government agencies have to do their own
detailed analysis.
42
National Overall Reference Architecture (NORA) – Handbook
S/No
e-Transformation
Maturity
Likely EA Value Proposition(s)
1 LOW a.	 Align government agency projects with Saudi e-Government
Action Plan
b.	 Aid planning and prioritizing government agency-wide
action plan
c.	 Improve service quality to citizens and businesses
     Prioritize IT projects
2 MEDIUM a.	 Align government agency projects with Saudi e-Government
Action Plan
b.	 Aid planning and prioritizing government agency-wide action
plan
c.	 Improve service quality to citizens and businesses
d.	 Increase productivity
e.	 Prioritize and improve IT investments for government agency
f.	 Reduce wastage of IT costs
g.	 Identify consolidation projects to reduce IT cost and better
management
h.	 Develop inter-operability standards within government
agency and inter-agency
3 HIGH a.	 Prioritize and improve both business and IT investments for
government agency
b.	 Business and technology innovation to deliver highly integrated,
value-added services
c.	 Significant performance improvements for the government
agency
Table ‎3-3: Likely EA value proposition based on e-Transformation maturity
43
National Overall Reference Architecture (NORA) – Handbook
Below are examples of local government agencies’ EA drivers – i.e. the motivation reasons or
purposes in developing their own EAs.
Government Agency EA drivers
The National Information Center
(Technology arm of Ministry of
Interior)
1.	 Lack of agency-wide view to govern projects (both
business & IT) and resources
2.	 Duplicated investments especially in IT
3.	 Inefficient and ineffective in delivering quality and
timely government services
4.	 Operational difficulties due to abundance of non-
standardized infrastructure and technologies
The National Center for Education
Information (Ministry of Education)
1.	 Lack of agency-wide view to govern projects (both
business & IT) and resources
2.	 Duplicated investments especially in IT
3.	 High demand for IT services and solutions
4.	 Complex business and IT landscapes
5.	 Organizational difficulties such as ineffective
      communications, lack of transparency and
      inefficiency
Ministry of Education
(Higher Education) – Safeer Program
1.	 No organizational-wide view of services, applications,
business processes, data and IT infrastructure that
affect strategic decision making
2.	 High IT operational costs
3.	 Operational complexity
National Center for Assessment in
Higher Education (Qiyas)
1.	 Lack of organizational-wide governance
2.	 Not business-driven; instead IT-led
3.	 Improve the delivery of quality services
4.	 Operational complexity & high costs
5.	 Performance limitations
Table ‎3-4: Local examples for EA drivers or purposes
44
National Overall Reference Architecture (NORA) – Handbook
3.4.4 Step 1.4 Document government agency’s EA project strategy
After some EA awareness sessions and followed by the approval from the top management or
e-Transformation Committee, there should be sufficient driving factors by now to embark on
the EA development. It is vital, however, to document an EA Project Strategy clearly describing
the goals, expected outcomes, and project schedule with a list of resources required.
The EA Project Strategy should focus on strategic and long-term outcomes for the government
agency. In the next step, a more detailed EA Project Plan will be created. For this step, the EA
Project Strategy should cover the following topics:
1.	 The EA Value Propositions or Purposes
2.	 Goals or Objectives of the EA Project
3.	 Scope and Schedule of the EA Project
4.	 EA Development Considerations and Approach (including phase/gradual development strategy
and sourcing method i.e. In-House or Out-Source)
5.	 Estimated Cost and Resources (Staff) Requirements.

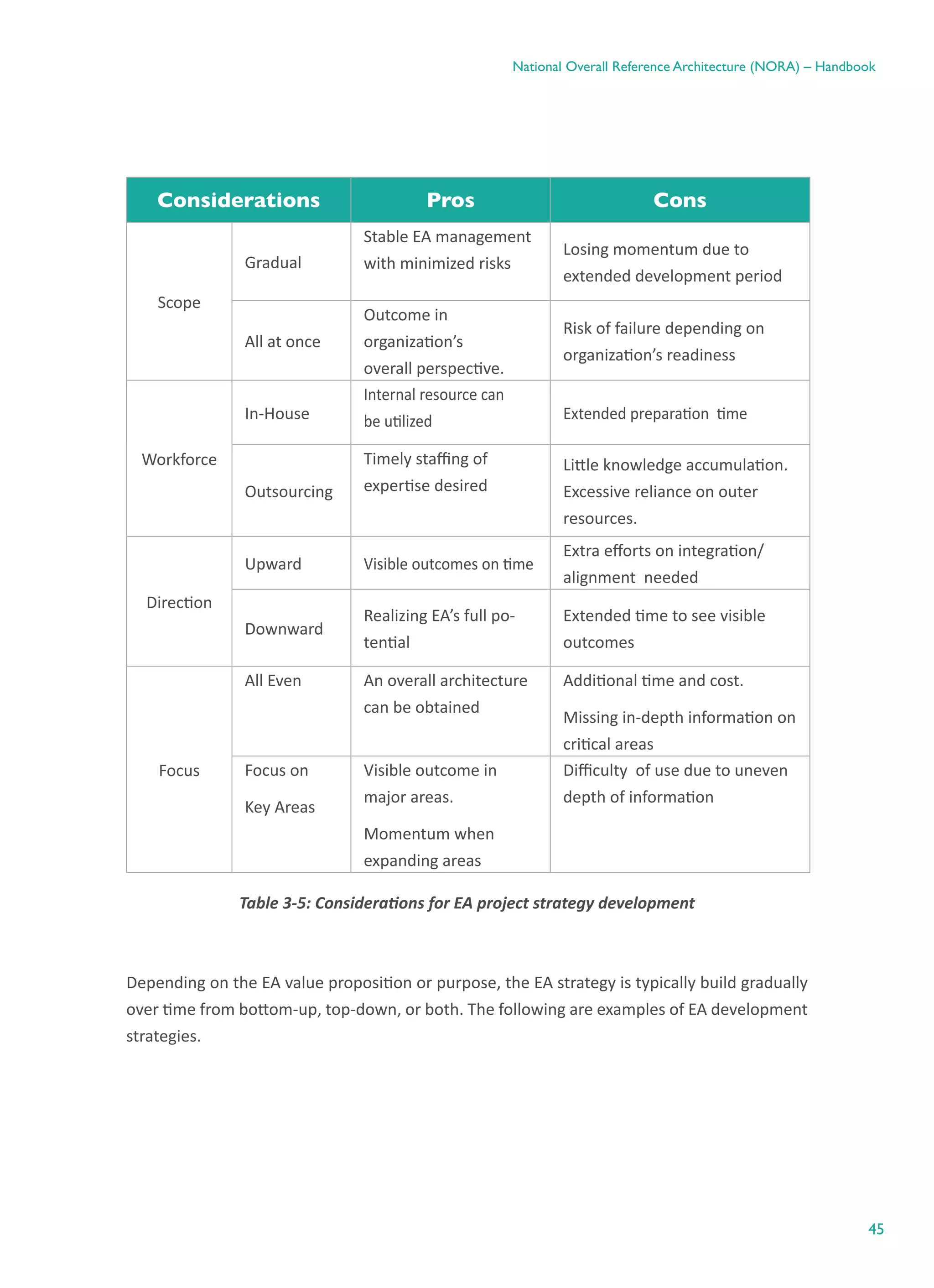

Table 3-4 illustrates the key considerations in developing the EA Project Strategy.
45
National Overall Reference Architecture (NORA) – Handbook
Considerations Pros Cons
Scope
Gradual
Stable EA management
with minimized risks
Losing momentum due to
extended development period
All at once
Outcome in
organization’s
overall perspective.
Risk of failure depending on
organization’s readiness
Workforce
In-House
Internal resource can
be utilized Extended preparation  time
Outsourcing
Timely staffing of
expertise desired
Little knowledge accumulation.
Excessive reliance on outer
resources.
Direction
Upward Visible outcomes on time
Extra efforts on integration/
alignment  needed
Downward
Realizing EA’s full po-
tential
Extended time to see visible
outcomes
Focus
All Even An overall architecture
can be obtained
Additional time and cost.
Missing in-depth information on
critical areas
Focus on
Key Areas
Visible outcome in
major areas.
Momentum when
expanding areas
Difficulty  of use due to uneven
depth of information
Table ‎3-5: Considerations for EA project strategy development
Depending on the EA value proposition or purpose, the EA strategy is typically build gradually
over time from bottom-up, top-down, or both. The following are examples of EA development
strategies.
46
National Overall Reference Architecture (NORA) – Handbook
Figure ‎31: Example of bottom-up development strategy
Figure ‎32: Example of mixed development approach
3.4.5 Step 1.5 Present and obtain approval for EA project strategy
Present and get approval on the EA Project Strategy from the e-Transformation Committee or
equivalent. Note that this is not an easy task and may need a few iterations. The recommended
activities are:
1.	 From the awareness sessions, the team can have a good idea who can provide good direc-
tions, requirements and supportive of the EA project. Thus, obtain feedback on the EA
project strategy from these key stakeholders
2.	 In addition to the EA project strategy documentation, prepare a precise yet effective pre-
sentation slides
3.	 Present to the key stakeholders and other EA supporters. From their feedback, update the
presentation slides and EA project strategy document respectively
4.	 Finally, present the e-Transformation Committee or equivalent for approval.
47
National Overall Reference Architecture (NORA) – Handbook

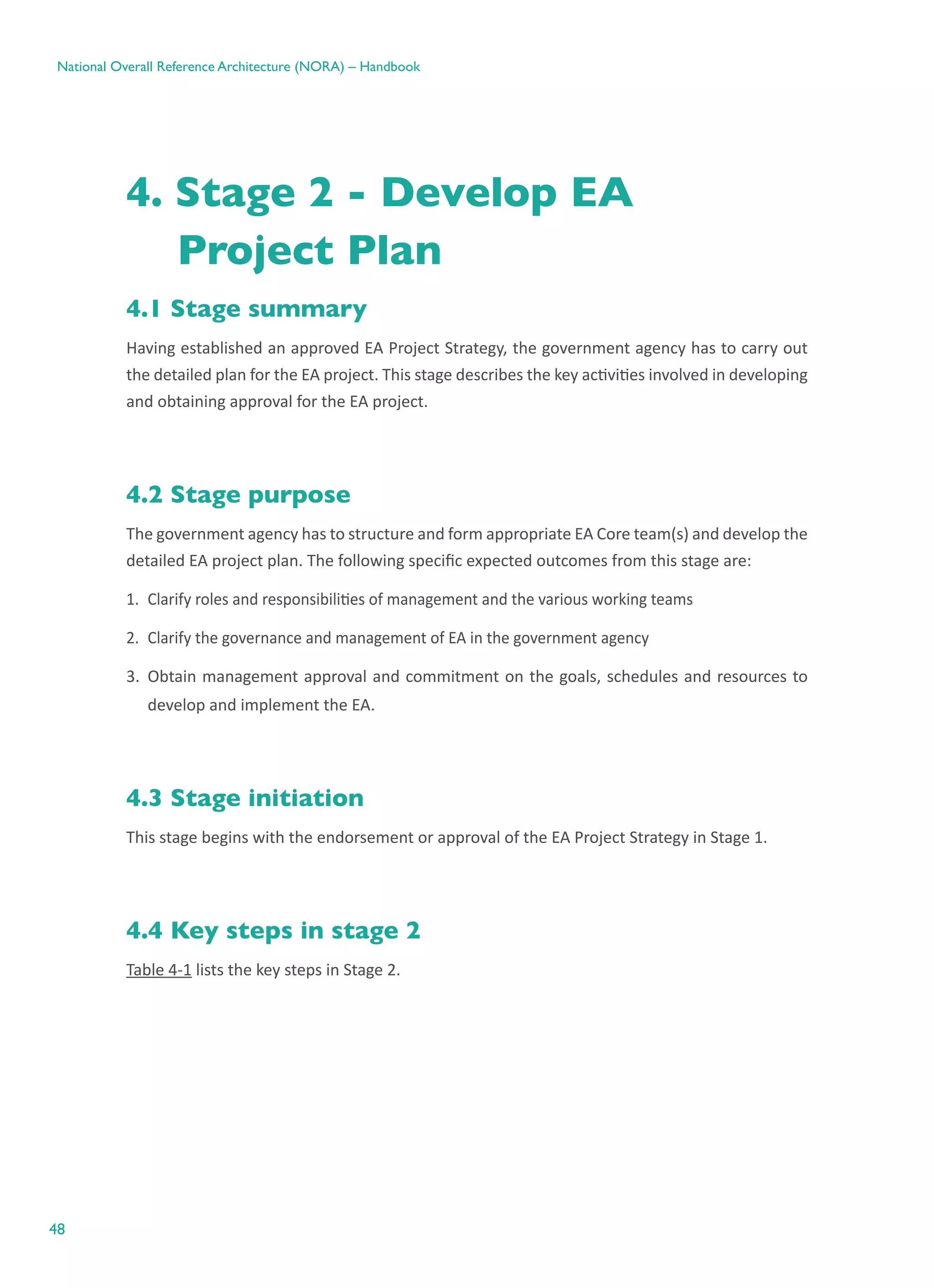

4.Stage2-Develop
EAProjectPlan
48
National Overall Reference Architecture (NORA) – Handbook
4. Stage 2 - Develop EA
Project Plan
4.1 Stage summary
Having established an approved EA Project Strategy, the government agency has to carry out
the detailed plan for the EA project. This stage describes the key activities involved in developing
and obtaining approval for the EA project.
4.2 Stage purpose
The government agency has to structure and form appropriate EA Core team(s) and develop the
detailed EA project plan. The following specific expected outcomes from this stage are:
1.	 Clarify roles and responsibilities of management and the various working teams
2.	 Clarify the governance and management of EA in the government agency
3.	 Obtain management approval and commitment on the goals, schedules and resources to
develop and implement the EA.
4.3 Stage initiation
This stage begins with the endorsement or approval of the EA Project Strategy in Stage 1.
4.4 Key steps in stage 2
Table 4-1 lists the key steps in Stage 2.
49
National Overall Reference Architecture (NORA) – Handbook
Stage /
Step No
Description Deliverable
2 Develop EA Project Plan Government Agency’s EA Project Plan
2.1 Upon approval of the Project Strategy
(Step 1.4), propose and set up the vari-
ous EA committees and teams such as EA
Governance Committee, EA Working Team,
Business-Domain Working Team and the IT
Working Team.
Approved EA committees and working
teams by the e-Transformation
Committee or equivalent
2.2 Finalize the EA development approach such
as scope, budget, schedule, and including
outsourcing or insourcing of the Government
Agency’s EA implementation. Also include
the adoption of EA culture into all aspects
of business and IT planning and reviews
Approved EA development approach
by e-transformation committee or
equivalent
2.3 Upon approval of Steps 2.1 & 2.2, the EA
working team will document the detailed EA
Project Plan
Draft EA project plan
2.4 Present and obtain approval for the EA
project plan
Approved EA project plan by the EA
Governance Committee
Table ‎4-1: Stage 2 steps
4.4.1 Step 2.1 Set up EA committees and working teams
The first activity is to set up the necessary committees and working teams. Depending on the
government agency’s EA goals and scope, the type of committees and working teams may vary.
Although every government agency has an e-Transformation Committee that oversees the
overall development and progress of the e-Government transformation, there is a need for an
EA governance committee to oversee and direct the progress of the EA development project. EA
is one of the main enablers for an effective e-Government transformation. Typically, one of the
e-transformation committee members (i.e. the main EA sponsor) will chair the EA governance
committee. Table 4-2 lists the common committees and working teams for a government EA
development project, while Figure 4-1 shows a example EA organizational structure. Note that
these are only recommendations. Government agencies have to find the best organizational
structure for its EA project.
50
National Overall Reference Architecture (NORA) – Handbook
S/No
Name of
Committee /
Working Team
Responsibilities Members
1 EA Governance
Committee
a.	 Steers and provides strategic government
agency-wide directions
b.	Empowers the working teams with account-
abilities and resources
c. 	Makes strategic decisions on EA recommen-
dations that affect the whole-of-govern-
ment agency (including its branches if any)
d.	Raise up matters or issues affecting govern-
ment agency-wide and inter-agency col-
laborations
e. Reviews and endorses the EA Project plans,
frameworks and reference models
f. Reviews and approves strategic policies and
actions as
recommended by the EA Core Team.
The government agency
e-Transformation Committee (if exist)
can also play another role as the EA
Governance Committee.
Alternatively, the members
recommended are:
i.	 Deputy Under Secretary / Deputy
CEO / Deputy DG as Chairperson
(basically the 2nd highest person in
the government agency)
ii.	 CxO(s)
iii.	CIO / IT Director
iv.	Chief Architect
(could be an outsourced role)
v.	 Directors of core
	 business functions.
2 EA Core Team a.	 Architects the government agency’s EA
b.	Develops EA framework and reference mod-
els
c.	 Recommends strategic directions, policies
and projects for the whole-of-government
agency.
i.	 Chief Architect
ii.	 Business Architect
iii.	Application Architect
iv.	Data Architect
v.	 Technology Architect
vi.	EA Working Team members (see below).
3 EA Working Team a.	 Develops the various EA Reference Models
and Standards
b	 Maintains the EA
	 artifacts
c.	 Provides trainings and awareness to the
government agency.
i.	 Business domain experts in+the core
government agency’s functions
ii.	 IT Manager
iii.	IT engineer who is in charge of infra-
structure and technology matters
iv.	Database Administrator (DBA)
v.	 Application Analyst.
Table ‎4-2: Typical government EA committees and working teams
51
National Overall Reference Architecture (NORA) – Handbook
Some important notes:
1.	 EA project is not only about IT. Hence, it is important that sufficient staff from the business do-
mains are involved. The business domains experts should be experienced and have good detailed
knowledge about the government agency’s main businesses.
2.	 It is also recommended to get the business experts who are in charge of the core e-services and
customer/citizen service relationship (if any)
3.	 As for the IT staff members, they should be experienced and are leading specific teams such as
infrastructure, database and applications.
Figure 4-1 illustrates an example of the EA organizational structure.
Figure ‎4-1: Example of EA organizational structure
52
National Overall Reference Architecture (NORA) – Handbook
In addition to the organizational structure of the committees and working teams, it is also a
necessity to define basic governance or management processes relating to the approval of
projects and activities. The tables below provide different governance/management areas for
considerations and example cases use in government agencies respectively. For more details on
governance, please refer to the section “Continuous Governance”,
Management
Field
Key Content
Program Management
1.	Track the progress of the EA project
2.	Provide updates to the EA Governance Committee
3.	Highlight or alert issues pertaining to schedule, resources and
budget.
Change Management
1.	Ensure quality of content in the EA deliverables and artifacts
2.	Control and approve changes and publishing of artifacts
3.	Agree on removal or deletion of obsolete artifacts.
Performance Management
1.	Analyze and review impact of EA on the government agency
2.	Measure the usefulness of EA in different aspects and operations
of the government agency
3.	Approve the areas of improvement as described in the EA’s
recommendations.
Capability Management
1.	Identify skills for development in the government agency
2.	Identify departments, division or business functions that require
increased or improved capabilities
3.	Approve on training programs and incentives.
Table ‎4-3: Governance / Management fields
53
National Overall Reference Architecture (NORA) – Handbook
Government
Agency
Management Scope
The Ministry of AAA
• EA progress management group
• EA progress management procedure
  - Progress management procedure, change request · re-
view, decision-making on changes, EA synchronization, EA
re-composition, EA release
The Ministry of BBB
• EA management group
• EA work planning
  -  EA project planning, EA observance, EA change, EA use sup-
port, EA system operation, EA assessment
• Management support tool
  -  management guideline, training planning, change manage-
ment, transition plan, performance model
The Ministry of CCC
• EA management group plan
• EA management process
• EA maturity model
• EA management guideline
Table ‎4-4: Examples of governance / management fields in government agencies
These recommendations on committees / working teams and governance processes have to be
approved by the e-Transformation Committee or equivalent. On approval, these committees
and working teams can officially embark on the detailed EA development work. Please refer to
the ‘Continuous Governance’ section for more details.
54
National Overall Reference Architecture (NORA) – Handbook
4.4.2 Step 2.2 Finalize EA development approach
The result of Stage 1 was the high-level EA Project Strategy developed by a small group of
individuals. As EA is a wide topic with many factors, it is a prudent approach to develop a more
detailed EA Project Plan with inputs from various perspectives within the government agency.
With the setup of the various EA committees and working teams, the official EA work can begin.
The EA Core Team and the various working teams can meet, discuss and finalize on the following:
1. EA Objectives / Goals
Agree on the primary objectives or goals of the EA project. The initial objectives or goals defined
in the EA Project Strategy have to be reviewed and discussed with the new members in the EA
Core Team and working teams. It is common that the EA objectives or goals are and/or amended.
2. EA Scope
The EA Core Team and working team members need to have detailed discussion on what entails
the EA development scope for the government agency. The EA scope will affect the resources
required, time and budget. With inputs from different members, there is a tendency that the
scope can be specific. The government agency also has to consider a gradual or consolidated
scoping i.e. to do everything in the EA at once or to build the EA gradually over time. The EA
Core Team or Chief Architect has to normalize or find a balance in the EA scoping. Below are
some examples of the EA scopes.
55
National Overall Reference Architecture (NORA) – Handbook
Item Specific Scope
Current
/ Target
Architecture
1.	What was the primary Purpose for developing EA?
2.	Is the primary purpose to develop future business and IT blueprints?
3.	 Is the primary purpose to manage effectively the current IT resources?
Architecture
Scope and
Level
1.	An agency with no EA experience would better off with a gradual
approach.
2.	The T-approach (overall architecting + in-depth architecting on cer-
tain areas) can be taken as needed.
3.	Gradual scoping  appropriate to EA purposes
4.	A current architecture should be detailed enough to perform an
overall analysis.  Target architecture should be drawn at the planner
level and contain details down to the developer level.
Business
/ Application
/ Data
/ Technology
/ Security
1.	Is business process improvements?
2.	Is there a need to align IT projects with the business objectives?
3.	Is a data renovation such as data standardization or data sharing
urgent?
4.	 Is there an urgent need for IT standardization or IT asset management?
Table ‎4-5: Examples of EA scope
56
National Overall Reference Architecture (NORA) – Handbook
Gradual Scoping Examples
1
a. On some domains (Strategy, Business, IT etc.)
b. Vision / Principles, Framework, Reference Models
c. Current and Target Architecture
d. Transition Plan
e. Training / Promotion
2
a. On all domains
b. Current and Target Architecture
c. Transition Plan
e. EA Tool
f. Training/Promotion
g. EA Maturity Level Assessment
3
a. EA Use and Management Plan
b. Guideline Revision
c. Reinforce EA Environment
d. Training/Promotion
e. EA Expertise (Internal Architects)
Table ‎4-6: Examples of EA gradual scoping
3. Development Approach
In Stage 1, the EA Strategy has probably described the development strategy. This is typically a
phased approach such as bottom-up, top-down or mixed. In this stage, the EA Core Team and
other development teams have to review and further discuss the best approach taking into
consideration the changes made to the EA scope. Depending on the actual EA value proposition
or purposes, the following are recommended:
57
National Overall Reference Architecture (NORA) – Handbook
S/No
EA Objectives /
Values
Strategy
1 Understanding agency-wide
perspective on  issues,
problems, challenges, etc.
Carry out both business and IT landscape studies. This in-
formation are valuable for both business and IT planning
activities, and they are pre-amble to the EA activities.
2 IT Standardization especially
for infrastructure, databases
and applications
Develop the technology Architecture including IT stan-
dards and guidelines as the first major EA deliverable.
3 Tuning and Consolidation of IT
Infrastructure
Develop the Technology Architecture including IT stan-
dards and guidelines as the first major EA deliverable. In
particular, architect for shared and consolidated IT infra-
structure environment. Use Return-on-Investment (ROI)
as a financial justification for the consolidation exercise.
4 Consolidating data elements
and data exchange
Develop the Data / Information Architecture as the main
deliverable. However, need physical solution such as net-
work, databases, storages, etc. Recommended to next
develop the Technology Architecture and then implement
the data consolidation exercise.
5 Application consolidation Develop the Application Architecture. However, need
physical solution such as servers, databases, storages,
etc. Recommended to next develop the Technology Ar-
chitecture and then implement the application consoli-
dation exercise.
6 Business and service improve-
ment, delivery
First, develop the Business Architecture. Document
all the key business processes and services. Develop a
methodology to select business processes and services
for improvements. Recommended to develop the Appli-
cation or Technology Architecture subsequently.
7 Reviewing and improving major
program
Ensure that the program scope is clear. Recommended
to develop the Business Architecture first. The other IT-
related Application, Data and Technology architectures
can start in parallel.
8 Business and IT Alignment and
Investment
Recommended to first develop the Technology Ar-
chitecture. Next, develop the Business Architecture.
If possible, also develop the Application Architecture
(but if this is not possible due to time, then simply lists
the entire application inventory to establish the busi-
ness function and application relationship). Carry out
a gap analysis study and provide recommendations for
improvements.
Table ‎4-7: Development approach recommendations
58
National Overall Reference Architecture (NORA) – Handbook

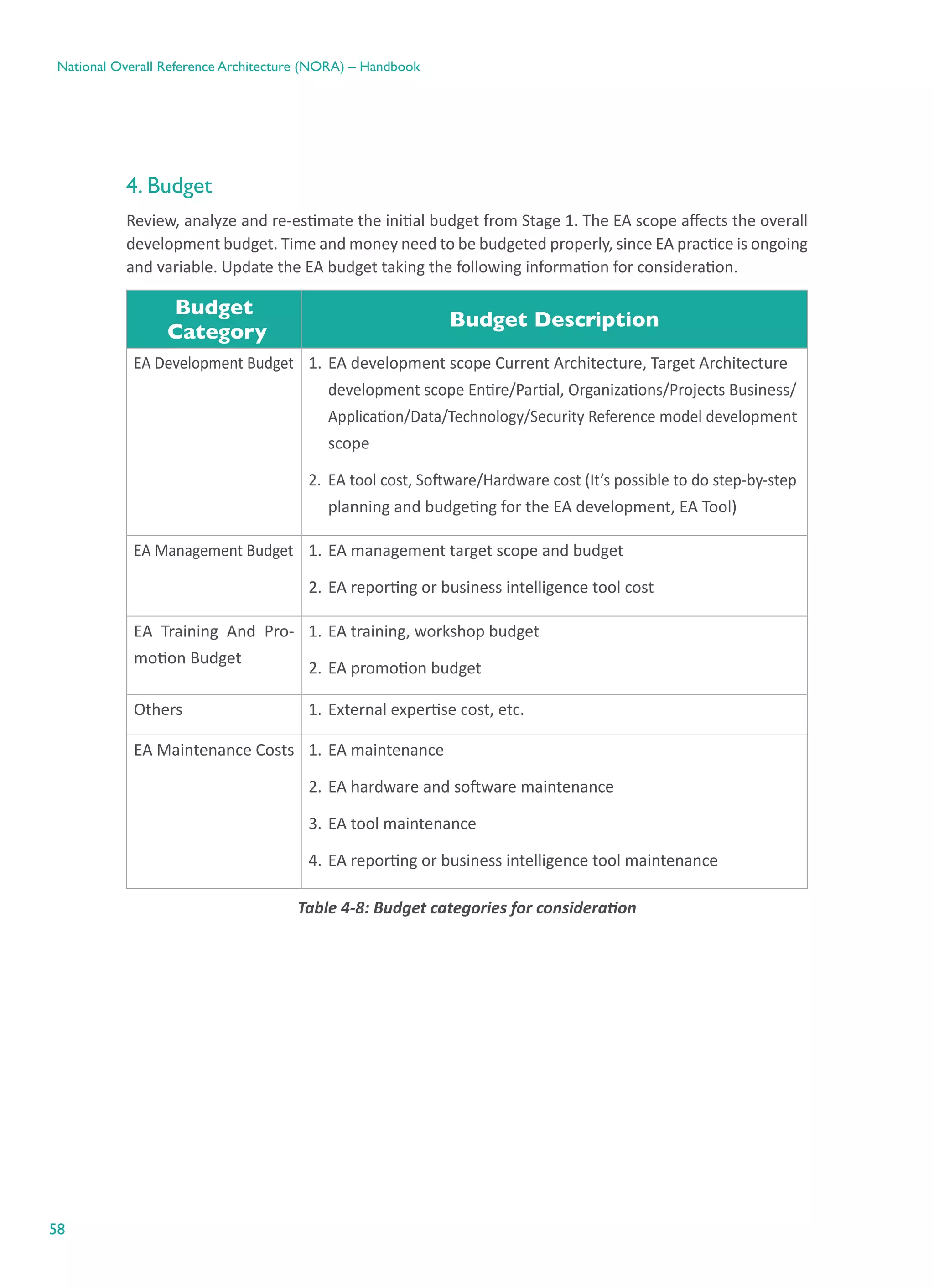

4. Budget
Review, analyze and re-estimate the initial budget from Stage 1. The EA scope affects the overall
development budget. Time and money need to be budgeted properly, since EA practice is ongoing
and variable. Update the EA budget taking the following information for consideration.
Budget
Category
Budget Description
EA Development Budget 1.	EA development scope Current Architecture, Target Architecture
development scope Entire/Partial, Organizations/Projects Business/
Application/Data/Technology/Security Reference model development
scope
2.	 EA tool cost, Software/Hardware cost (It’s possible to do step-by-step
planning and budgeting for the EA development, EA Tool)
EA Management Budget 1.	EA management target scope and budget
2.	EA reporting or business intelligence tool cost
EA Training And Pro-
motion Budget
1.	EA training, workshop budget
2.	EA promotion budget
Others 1.	External expertise cost, etc.
EA Maintenance Costs 1.	EA maintenance
2.	EA hardware and software maintenance
3.	EA tool maintenance
4.	EA reporting or business intelligence tool maintenance
Table ‎4-8: Budget categories for consideration
59
National Overall Reference Architecture (NORA) – Handbook
5. Roadmap
A critical review of the milestones or schedule is necessary. The EA Core Team and working
teams have to list and prioritize the expected EA deliverables based on the EA scope. Considerations
affecting the schedule includes alignment to the 2nd Saudi e-Government Action Plan, the
government agency plans and any need for compliance with Saudi Government policies or
projects.
At this stage, appoint a Project Manager so that the EA Transition Roadmap can be prepared
jointly with EA Core Team. From the EA Transition Roadmap, the next step will develop a detailed
Project Plan. Below are examples of EA Transition Roadmap.
Figure ‎4-2: Example of EA transition roadmap
60
National Overall Reference Architecture (NORA) – Handbook
6. Usefulness of EA
The final part of the EA development approach is to describe the usefulness of the government
agency’s EA that has to match with the original EA Value Proposition(s). Thus, the EA Core Team
and working teams have to discuss and list the usefulness of EA especially for the different
stakeholders. Table 4-9 describes some of the usefulness of EA.
Usefulness Key Content
Use in IT planning 1.	 Check project overlapping, reuse, criteria compliance, etc. in the vision of
whole agency
2.	 Check alignment with agency’s vision, purposes, and target architecture
3.	 Reflect on IT investment decision and relations.
Use in project
execution
1.	 Identify work status, IT systems status, target system requirements,
target of reuse, target of shared use, standardization requirements,
etc. and reflect them on business plan, work instruction, etc.
2.	 IT entrepreneur can analyze work status & IT status by using current ar-
chitecture and, he can perform business by using EA principles, reference
model, target architecture, etc.
Use in IT resource
management
1.	 Apply EA principles, reference model, standard, etc. to IT resources
management, such as their identification, standardization, reuse,
implementation, disuse, etc.
Use in Business
Process
Re-Engineering
1.	 EA can identify areas for Business Process Re-Engineering, and to build a
roadmap for automation of those business processes, in such a case the
focus would be more on the Business Domain of EA and less focus on the
other domains.
Table ‎4-9: Description on the EA usefulness
61
National Overall Reference Architecture (NORA) – Handbook

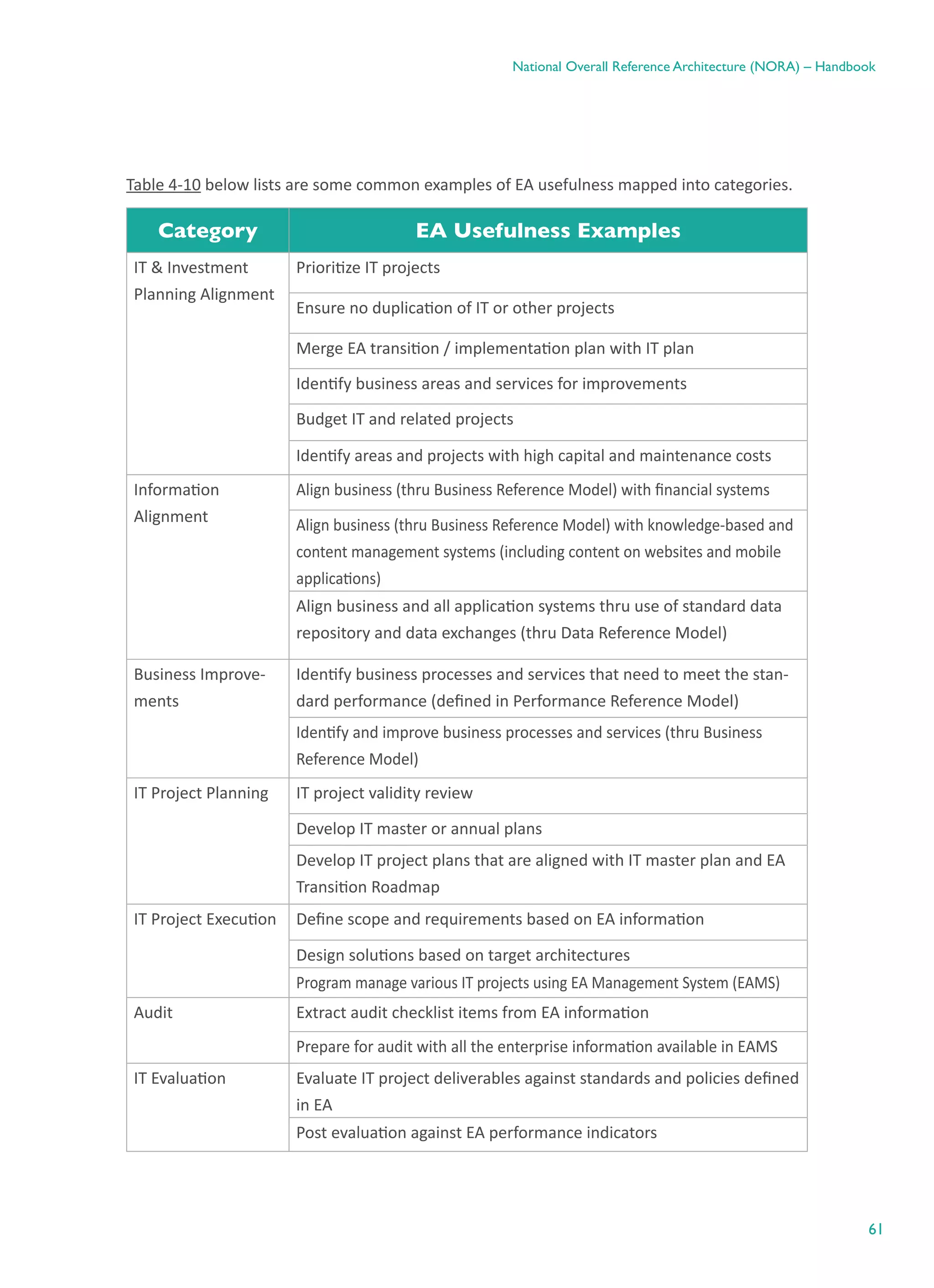

Table 4-10 below lists are some common examples of EA usefulness mapped into categories.
Category EA Usefulness Examples
IT & Investment
Planning Alignment
Prioritize IT projects
Ensure no duplication of IT or other projects
Merge EA transition / implementation plan with IT plan
Identify business areas and services for improvements
Budget IT and related projects
Identify areas and projects with high capital and maintenance costs
Information
Alignment
Align business (thru Business Reference Model) with financial systems
Align business (thru Business Reference Model) with knowledge-based and
content management systems (including content on websites and mobile
applications)
Align business and all application systems thru use of standard data
repository and data exchanges (thru Data Reference Model)
Business Improve-
ments
Identify business processes and services that need to meet the stan-
dard performance (defined in Performance Reference Model)
Identify and improve business processes and services (thru Business
Reference Model)
IT Project Planning IT project validity review
Develop IT master or annual plans
Develop IT project plans that are aligned with IT master plan and EA
Transition Roadmap
IT Project Execution Define scope and requirements based on EA information
Design solutions based on target architectures
Program manage various IT projects using EA Management System (EAMS)
Audit Extract audit checklist items from EA information
Prepare for audit with all the enterprise information available in EAMS
IT Evaluation Evaluate IT project deliverables against standards and policies defined
in EA
Post evaluation against EA performance indicators
62

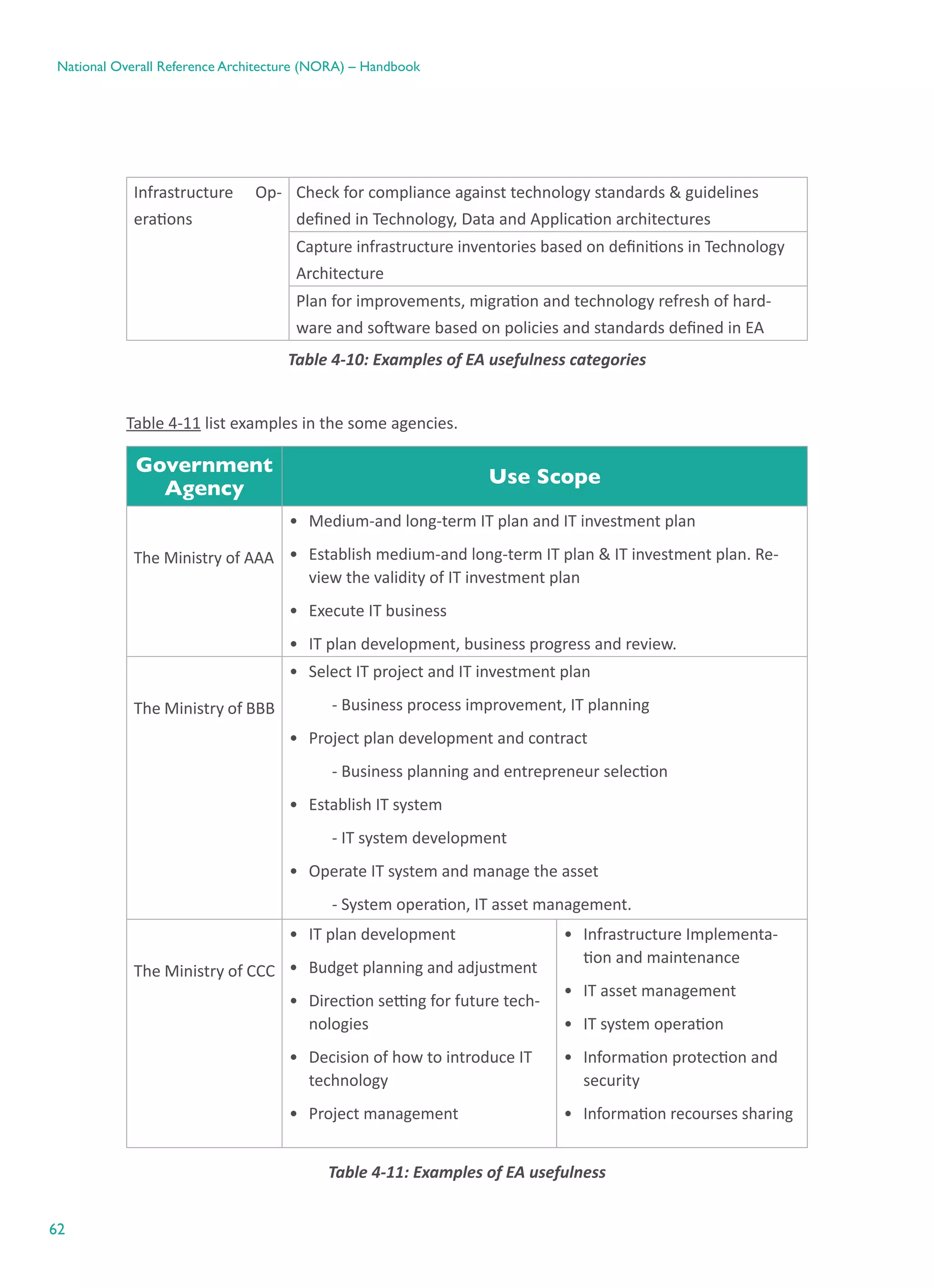

National Overall Reference Architecture (NORA) – Handbook
Infrastructure Op-
erations
Check for compliance against technology standards & guidelines
defined in Technology, Data and Application architectures
Capture infrastructure inventories based on definitions in Technology
Architecture
Plan for improvements, migration and technology refresh of hard-
ware and software based on policies and standards defined in EA
Table ‎4-10: Examples of EA usefulness categories
Table 4-11 list examples in the some agencies.
Government
Agency
Use Scope
The Ministry of AAA
•	 Medium-and long-term IT plan and IT investment plan
•	 Establish medium-and long-term IT plan & IT investment plan. Re-
view the validity of IT investment plan
•	 Execute IT business
•	 IT plan development, business progress and review.
The Ministry of BBB
•	 Select IT project and IT investment plan
- Business process improvement, IT planning
•	 Project plan development and contract
- Business planning and entrepreneur selection
•	 Establish IT system
- IT system development
•	 Operate IT system and manage the asset
- System operation, IT asset management.
The Ministry of CCC
•	 IT plan development
•	 Budget planning and adjustment
•	 Direction setting for future tech-
nologies
•	 Decision of how to introduce IT
technology
•	 Project management
•	 Infrastructure Implementa-
tion and maintenance
•	 IT asset management
•	 IT system operation
•	 Information protection and
security
•	 Information recourses sharing
Table ‎4-11: Examples of EA usefulness
63
National Overall Reference Architecture (NORA) – Handbook
Present the EA development approach to the EA Governance Committee for approval.
4.4.3 Step 2.3 Document detailed EA project plan
Having obtained the EA Governance Committee’s feedback and approval on the EA develop-
ment approach, the team can start documenting the detailed EA Project Plan that will elabo-
rate on the objectives, scope, schedules, funding and project management details. The previ-
ous outputs, such as the EA development approach, will be use to prepare the EA Project Plan
that will be used to track and monitor the progress of all the key steps and activities in the
development of the government agency’s EA.
Following is an example format for project plan. It is also advisable to prepare the detailed proj-
ect schedule based on Microsoft Project.
1. EA Initiative Overview
A. Background and Rationale
•	 Specify background and rationale of EA project plan, according to domestic/overseas envi-
ronment changes
•	 Specify agency’s IT status and EA rationale in order to solve relative issues
•	 Specify background and rationale of EA project plan in a view of agency’s goals to be
achieved by EA implementation ⋅ development
B. Provision
•	 Write down service/process’s improvement which can be made by EA after EA implementation
C. Scope
•	 Specify scope of EA development project
•	 Specifying EA project’s key contents & EA development scope, since detailed project scope/
contents can be written down in ‘Request for Proposal’
D. Expected outcome
•	 Write down qualitative, quantitative expected outcomes made after completing EA project
•	 It is required to present clearly expected outcomes the agency wants to have through the
project since they are related with project’s overall direction.
64
National Overall Reference Architecture (NORA) – Handbook

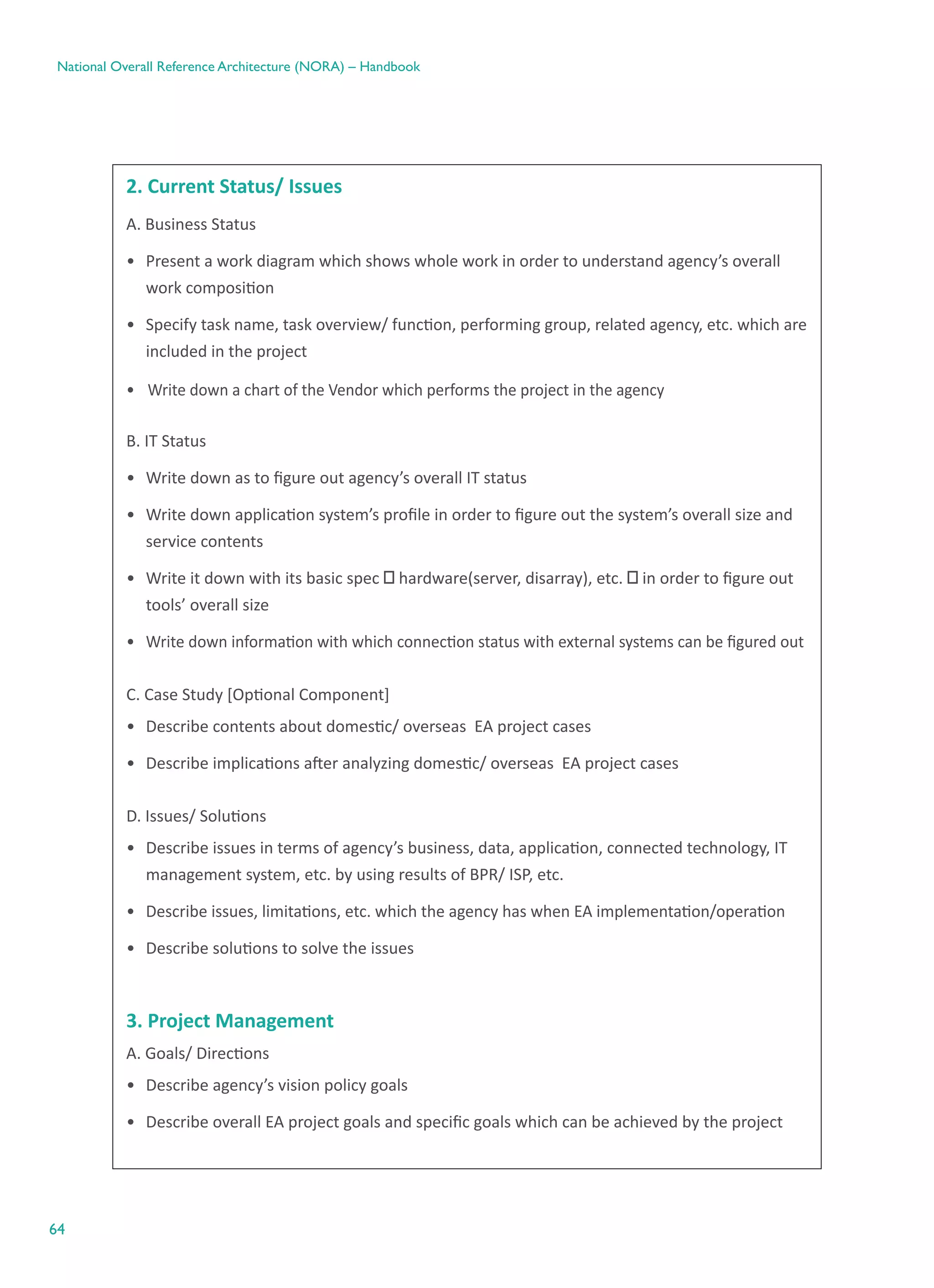

2. Current Status/ Issues
A. Business Status
•	 Present a work diagram which shows whole work in order to understand agency’s overall
work composition
•	 Specify task name, task overview/ function, performing group, related agency, etc. which are
included in the project
•	 Write down a chart of the Vendor which performs the project in the agency
B. IT Status
•	 Write down as to figure out agency’s overall IT status
•	 Write down application system’s profile in order to figure out the system’s overall size and
service contents
•	 Write it down with its basic spec ㅡ hardware(server, disarray), etc. ㅡ in order to figure out
tools’ overall size
•	 Write down information with which connection status with external systems can be figured out
C. Case Study [Optional Component]
•	 Describe contents about domestic/ overseas  EA project cases
•	 Describe implications after analyzing domestic/ overseas  EA project cases
D. Issues/ Solutions
•	 Describe issues in terms of agency’s business, data, application, connected technology, IT
management system, etc. by using results of BPR/ ISP, etc.
•	 Describe issues, limitations, etc. which the agency has when EA implementation/operation
•	 Describe solutions to solve the issues
3. Project Management
A. Goals/ Directions
•	 Describe agency’s vision policy goals
•	 Describe overall EA project goals and specific goals which can be achieved by the project
65
National Overall Reference Architecture (NORA) – Handbook
[Example of Project Purposes by an Agency]
Keyword The Ministry
of AAA
The Ministry
of BBB
The Ministry
of CCC
The Ministry
of DDD
The Ministry
 of EEE
Common use of Information O O
Interoperability O O
IT System Development O O O
Connection of Work with IT O O O O O
Using as a Innovation Tool O O
EA Implementation Base Devel-
opment
O O
IT Base Development O O O
Standardization O O O
B. Project Strategy
•	 Describe project strategies suitable to agency’s characteristics
•	 Describe project strategies as to draw success factors from trial projects and other case stud-
ies and then, perform the project
•	 Describe whether standard factorsㅡsuch as national EA standard framework, reference
model, standard artifact metamodel, etc. ㅡ is applied or not
•	 Describe whether technology assessment standards YEFI, NEA Framework, NORA etc. is
observed or not
C. Organization/ Process
•	 Describe required organizational structure and their roles
•	 Include CIO, Architecture Committee, Chief Architect, EA Core team, etc. into the agency
•	 Describe structured EA project planning’s responsibility/ roles
D. Schedule
•	 Mark project’s total time required, contact period, phase, main events, (beginning and com-
pleting session, workshop, law amendment, the first day of service, public hearing, etc.) etc.
4. Project Description
A. Project Overview
•	 Explain the project
66
National Overall Reference Architecture (NORA) – Handbook
B. Project Details
•	 Describe detailed project contents by each scope
•	 Describe detailed project contents by each phase
C. System Development
•	 Describe a diagram of target system, key functions, and compositions for EAMS development
5. Resources/ Budget
A. Budgeting (long-term)
•	 Describe total budget made during the project
•	 Describe how to secure budget
B. Budgeting (for the year)
•	 Describe required budget based on the year’s project scope
•	 Describe required budget of the year in detail according to type such as service charge, cost of
system setup, purchase of tools, etc.
•	 Describe estimation standard and estimated contents in detail
6. EA Use/ Management
A. EA Use
•	 Describe use plan, such as use purpose, use scope, etc. which are defined to use EA information
B. EA Management
•	 Describe management system , management purpose, management scope, etc. which are
defined to maintain EA information
Figure ‎4-3: Example format for EA project plan
4.4.4 Step 2.4 Present and obtain approval for the EA project plan
Prepare the presentation slides and review them. It is good to do a presentation to any inter-
ested stakeholders first such as CIO or IT department and a business department for their feed-
back. Finally present and get approval from the EA Governance Committee.
67
National Overall Reference Architecture (NORA) – Handbook
Continuous
Governance
68
National Overall Reference Architecture (NORA) – Handbook
5. Continuous Governance
5.1 Purpose of governance
With the approved EA project plan by the EA Governance Committee in the previous stage, the
EA Core and working teams can embark on the detail EA work. As EA is a massive and long-term
project, there are bound to be many challenges and issues. It is vital, therefore, that the EA
governance work is also address to ensure the success of the project.
The previous stage has defined he roles and responsibilities of the EA Governance Committee.
Hence, the purpose of the EA governance is very clear, i.e. to steer and direct the EA project to
successfully meet the government agency’s vision, mission and strategic goals. Recommended
that the EA Governance Committee report to the e-Transformation Committee or one of the
e-Transformation Committee members to chair the EA Governance Committee.
5.2 Outcomes of governance
The outcomes of the continuous governance are:
1.	Up-to-date project reporting on schedules, budget, progress and challenges
2.	Pro-active and timely review of deliverables and artifacts (instead of reactive management)
3.	Top-down transparency in solving challenges and issues across the government agency
4.	Effective management of resources in the government agency.
5.3 Governance initiation
The government agency’s e-Transformation Committee started the governance by reviewing
and approving the EA Project Strategy in Stage 1. The EA governance officially started with the
formation of the EA Governance Committee in Stage 2. Note that the EA governance is a con-
tinuous activity affecting all stages.
69
National Overall Reference Architecture (NORA) – Handbook
5.4 Key areas in EA governance
The key areas in EA governance are listed in Table 5-1.
Stage /
Step No
Description Deliverable
All Continuous Governance Success of Government Agency’s
EA Project
1. Track and monitor the key activities and
deliverables of the EA. Highlight to EA
Governance Committee on potential
delays, changes in scope, and lack of
resources
Program management of Gov-
ernment Agency’s EA implemen-
tation
2. Manage the introduction and changes to
the various activities in the EA. In particular,
carry out activities on EA awareness and
promotion
Change management especially
on  awareness and promotion of
Government Agency’s EA
3. Manage the capability requirements for
the EA implementation that includes
training, changes to job scope, and review
of division / department organizational
structures
Capability management on the
progression on the government
agency’s capabilities to carry out
the EA Project plans
4. Manage the policies and regulations re-
quired to implement the different factors
or activities of the EA in the government
agency
Policy management on the poli-
cies and regulations relating to
the EA execution
5. Manage the performance outcomes of
the EA in the government agency
Performance management on
the metrics, KPIs and outcomes
of the EA
Table ‎5-1: Continuous governance steps
As EA affects the whole of the government agency’s functions, and not merely IT, it is vital that
the EA Governance Committee has to carry out its governance functions throughout the EA
lifecycle.
70
National Overall Reference Architecture (NORA) – Handbook
The EA governance covers five areas as summarized in Figure 5-1 - program management,
change management, capability management, policy management and performance manage-
ment. Note that these five management areas have to be planned and executed together rather
than in sequence. Through program management, which acts as a central management area,
specific projects and tasks can be planned, scheduled and monitored. Details of these gover-
nance areas are describe below.
Figure ‎5-1: Five Aspects of EA governance
71
National Overall Reference Architecture (NORA) – Handbook
5.4.1 Program management
The EA will be a continuous journey with dynamic changes affecting different parts of the ar-
chitectures and reference models. The EA also recommends initiatives that require time to de-
velop and fully implemented.
The EA Core team must program manage the EA journey. The following are the key activities:
1.	 Update the program plan for the main initiatives and projects resulting from the development
phases, in particular the target architectures
2.	 Brief and propose on what and when to alert the EA Governance Committee for activities and
projects that are delayed, faced complex issues or require additional resources and funding
3.	 Have a regular meeting (e.g. monthly) to update the EA Governance Committee
4.	 Have a regular meeting (e.g. weekly) among the Chief Architect, EA Core team and working teams
5.	 Where possible, to delegate one specialist staff to manage one big program or project such as
change management, capability management, policy management and performance manage-
ment.
5.4.2 Change management
Before EA exists, the government agency has been organizing, planning and executing projects
(both business and IT) in typical manual and reactive fashion. The introduction of EA requires
big changes to the government agency such as organization review, integrated & strategic plan-
ning, and making decisions on e-Government transformation projects in a structured and time-
ly way. Thus, change management is necessary for the success of the EA execution.
Basis for change management
The plans for the long-term change management require approval from the EA Governance
Committee. In addition, constant updates to the EA Governance Committee and even to the
other top management in the government agency is recommended. This is to ensure that top
management or the e-Transformation Committee is aware of the progress and changes to the
EA program.
72
National Overall Reference Architecture (NORA) – Handbook

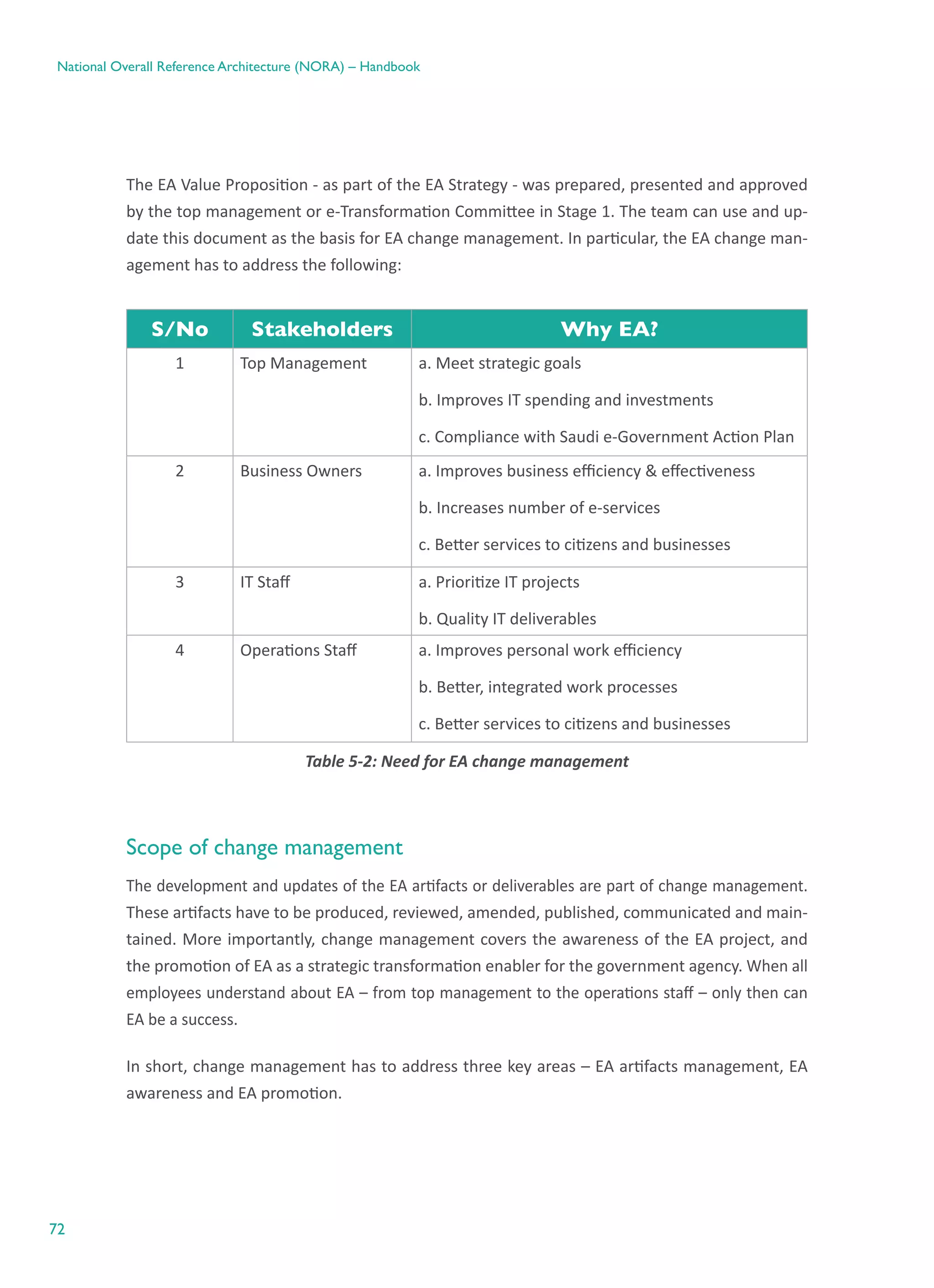

The EA Value Proposition - as part of the EA Strategy - was prepared, presented and approved
by the top management or e-Transformation Committee in Stage 1. The team can use and up-
date this document as the basis for EA change management. In particular, the EA change man-
agement has to address the following:
S/No Stakeholders Why EA?
1 Top Management a. Meet strategic goals
b. Improves IT spending and investments
c. Compliance with Saudi e-Government Action Plan
2 Business Owners a. Improves business efficiency & effectiveness
b. Increases number of e-services
c. Better services to citizens and businesses
3 IT Staff a. Prioritize IT projects
b. Quality IT deliverables
4 Operations Staff a. Improves personal work efficiency
b. Better, integrated work processes
c. Better services to citizens and businesses
Table ‎5-2: Need for EA change management
Scope of change management
The development and updates of the EA artifacts or deliverables are part of change management.
These artifacts have to be produced, reviewed, amended, published, communicated and main-
tained. More importantly, change management covers the awareness of the EA project, and
the promotion of EA as a strategic transformation enabler for the government agency. When all
employees understand about EA – from top management to the operations staff – only then can
EA be a success.
In short, change management has to address three key areas – EA artifacts management, EA
awareness and EA promotion.
73
National Overall Reference Architecture (NORA) – Handbook
1. EA Artifacts Management
As early as possible (at least by Stage 4 i.e. develop EA Framework), the EA Core team has to
establish artifacts management processes and standards that will ensure quality deliverables
are documented, updated and approved. The main processes are:
a. Artifact review and approval management process
b. Artifact release management process
c. Artifact change management process
d. Artifact compliance management process.
The EA Core team has to develop minimally the above management processes. Below is an
example of one the processes.
Artifact Review and Approval Management Process
As there will be many artifacts and documents produced in the course of the EA development,
it is necessary to have a standard process to review and approve the various documents. It is
assumed that the government has its own version control process in place (which is not covered
in NORA). Figure 5-2 illustrates an example process for the review and approval of artifacts.
74
National Overall Reference Architecture (NORA) – Handbook
Figure ‎5-2: Example of artifact review and approval process
In this example, there are four reviews before the final approval for the artifact or documenta-
tion. Each review starts by checking-out the artifact. The feedback for each review is collected
for amendment. Note that each review may have multiple occurrences. The basic description
of the reviews are as follows:
a. Core team review
Mainly the Chief Architect and the EA Core team members will do the first review. This review is
to ensure accuracy of content and the inter-relationships with other EA artifacts.
75
National Overall Reference Architecture (NORA) – Handbook
b.Working team review
The working team members can then review for applicability as they are aware of the specific
requirements and operational implications.
c. External review
The third review is by an external team that may be within the government agency or even oth-
ers. This review is to get inputs from stakeholders.
d. EA governance committee review
Finally, the governance committee will be presented with the artifact for their review and com-
ments.
For each of the four reviews, the EA Core team members have to do the following editorial tasks:
i.	 From the feedback obtained, update the artifact or document
ii.	 ‘Scrub’ the artifact or document for basic quality such as grammar & spell check, formatting,
fonts, etc. as defined in the EA documentation standard
iii.	Validate the artifact or document to ensure that correctness of basic content including com-
pliance to the EA documentation standard
iv.	This is followed by ‘proof read’. This step is to ensure that the content can be understood
v.	 Finally, the artifact or document is verified to ensure correctness of content and its inter-
relationships with other artifacts
vi.	The artifact or document is then check-in.
2. EA Awareness
The need and importance of EA has to be communicated to all the government agency staff, in
particular to the stakeholders identified above. Awareness campaigns such as presentations,
workshops and seminars can be conducted. It is recommended that the EA Core team and
working teams discussed the most effective ways to execute the awareness. The tables below
show examples of how and what content are to be provided in the EA awareness sessions.
76
National Overall Reference Architecture (NORA) – Handbook
Awareness Method Target Audience Frequency
Presentation (including updates on
EA Program)
Top Management Quarterly
Presentation IT Management Once
Presentation Business Owners Once
Workshop IT & Business Staff Quarterly
Table ‎5-3: EA awareness methods
Awareness Method
Estimate
Duration
Suggested Content
Presentation (Top Management) 1 hour
i.	 EA Goals & Objectives
ii.	 Need for EA in Government
Agency (i.e. benefits)
iii.	EA Transition Roadmap
iv.	Synergize EA with Strategies and
Investment Decisions
v.	 Progress Update
Presentation (IT and Business Own-
ers)
2 hours
i.	 EA Goals & Objectives
ii.	 Need for EA in Government
Agency (i.e. benefits)
iii.	High Level Current Architecture
iv.	High Level Target Architecture
v.	 EA Transition Roadmap
77
National Overall Reference Architecture (NORA) – Handbook
Workshop 1 day
i. EA Goals & Objectives
ii. National Enterprise Architecture
(NEA) for Saudi Government
iii. Need for EA in Government
Agency (i.e. benefits)
iv. Current Issues & Challenges
v. High Level Current Architecture
vi. Possible Solutions
vii. High Level Target Architecture
viii. EA Transition Roadmap
ix. How Can Staff or Division Contrib-
ute to EA
Table ‎5-4: Suggested content for EA awareness
As EA can only be a success if the government agency starts to think and act strategically, it may
be necessary to conduct additional awareness sessions to specific stakeholders such as the stra-
tegic and finance divisions. These stakeholders are potentially required to conduct integrated
strategic and financial investment decisions of the government agency.
3. EA Promotion
Complementing the awareness program above, the EA has to be promoted so that both man-
agement and operational staff in the government agency can identify the value that EA brings
forth. It is recommended that the EA Core team work with the media or public relations in the
government agency to finalize and implement the promotion. The following are the key steps
for consideration in the EA promotion:
78
National Overall Reference Architecture (NORA) – Handbook
Activity Description
Purpose of promotion Identify the actual purpose in the EA promotion. This may
affect the scope and budget of the promotion campaign
Understand how management and
staff receives promotional messages
Analyze the typical behavior when promotional messages
are communicated to management and operational
staff in the government agency. This helps to design the
promotion package
Design promotion key message While there are many goals and  benefits of EA, the team
needs to design a short message(s) that the
management and staff can understand
Design the tag line / logo Finally, design the tag line or phrase for the EA. This is
something catchy that can be easily remembered. Also
the team may consider designing a logo or special dia-
gram of the EA
Determine the effective media
for promotion
In addition to online media such as Intranet and email,
the team can consider other options including social me-
dia, videos, physical posters and physical gifts (e.g. mugs,
mouse-pad, and USB thumb-drive). Typically the promo-
tion has a number of these combinations
Produce and promote the EA With the above in place, the team can finally produce the
final EA promotion package
Table ‎5-5: EA promotion activities
It is also highly recommended to conduct an annual EA seminar to disseminate latest progress
updates and show the next projects in the pipeline. Other government agencies can also be
invited to share their success stories.
79
National Overall Reference Architecture (NORA) – Handbook
5.4.3 Capability management
Not only does EA requires a big organizational change, but it also requires commitment of the
government agency to continuously improve its capability – i.e. thought processes in executing
work, improving skills & experiences in architecting, improving business processes & automa-
tion, and in integrated planning & decision-making.
Complementing the change management, the capabilities of the government agency can be
classified into the following areas:
1. Enterprise Architecture
Although the Chief Architect, the EA Core team and working teams have completed the EA
development, the EA still requires continuous maintenance and updates. Hence, from a sustain-
ability perspective, the government agency requires sufficient staff trained in EA.
There is a need for specialization in the different areas of EA such as Business Architecture,
Application Architecture, Data Architecture and Technology Architecture. These specialization
requires additional training and learning from other architects.
2. Business Automation (including efficient use of IT devices)
Through EA, there will be proper alignment of business and IT. To see the outcomes of the EA,
however, requires effective business automation.
It is not simply to use IT to replace the manual way. More importantly, it is to review and im-
prove the business processes, and improve the team/division structure that executes these
processes. Capabilities such as ability to operate efficiently mobile devices, business process
re-engineering / improvement and organization reviews are required.
80
National Overall Reference Architecture (NORA) – Handbook
3. Integrated Planning
For a more effective planning and decision-making, EA aids the review, planning and managing
the projects in the government agency. The EA target architectures and reference models allow
synergy with the strategies / action plans of the government agency. This should be the focus
when the EA is fully completed (please see Execution Stage).
4. Service-based Outcomes
As Saudi government agencies continuously strive to improve their services to the citizens, busi-
nesses and government employees, it is necessary to deliver service-based outcomes. In other
words, government agencies have to consider what and how the government services can be
implemented that are useful for the public. The target outcomes of EA are objects, components
and services. For example, a government function is supported by application systems based on
a set of re-usable application components; in addition, the government function is made up of
a number of business processes that deliver specific services to the public. Through EA, services
and e-services are readily identified.
81
National Overall Reference Architecture (NORA) – Handbook
Table 5-6 summarizes the capabilities required in EA execution.
S/
No
Capability Description Who
1 Enterprise
Architects
To design, architect and implement enter-
prise IT-Business solutions and initiatives
Suggested Trainings:
i.	 NEA Briefing
ii.	 TOGAF/FEAF or similar
iii.	Visit similar government agency (local or
overseas) to learn EA experiences.
Staff who knows
both IT and Business
2 Business Process
Re-engineering
(BPR)
To review, improve and re-engineer the
efficiency and effectiveness of business
processes
Suggested Trainings:
i.	 BPR or similar
ii.	 Visit similar government agency (local
or overseas) to learn how they improve
their business processes.
Business Owners,
Business Process
Experts
3 Integrated
Planning
To plan as a government-wide integrated
program (rather than by division or by
resource e.g. IT & finance)
Suggested Trainings:
i.	 Corporate Integrated / Collaborative
Planning or similar.
Strategic Planners,
Enterprise
Architects, Business
Owners,
Corporate Planners
4 Public service
design
To design and implement services that are
needed by the public – i.e. citizens and
businesses. Also to provide outcomes as
services instead of government authorita-
tive requirements
Suggested Trainings:
i.	 Service value
ii.	 Public service design
Business Owners,
Operational Staff
Table ‎5-6: Capabilities required in EA
82
National Overall Reference Architecture (NORA) – Handbook
5.4.4 Policy management
In the development of the EA, the teams would have difficulties to identify things as a standard
or a guideline. While this is normal, the EA execution requires policies and regulations to ensure
a government agency-wide standardization and adoption of the various architectures / refer-
ence models.
For effective governance or management, the EA Core team and working teams have to prepare
and implement the relevant approved policies. It is recommended that these EA policies be
implemented in phases in conjunction with the Change Management Plan. Examples of policy
or regulation areas in EA are:
1.	 EA Usage Plan
2.	 EA Management Direction
3.	 Compliance to Project Approval Process
4.	 Compliance to Architectures & Reference Models
5.	 Compliance to Technology Standards.
1. EA Usage Plan
While the EA Core and working teams are busy preparing and developing the EA, the EA Gover-
nance Committee has to set clear directions on the eventual usage of the EA – i.e. when to use
or implement the EA (or parts of the EA) and who will implement the EA (in terms of divisions,
departments and branches).
The table below lists the main activities to identify EA usage plan direction and scenario, while
the subsequent diagram shows examples of EA usage direction. Clear policies or direction state-
ments can be defined and be communicated to all parties in the government agency on the us-
age of EA. The actual development of the detailed EA Usage Plan is typically carry out in Stage 9.
83
National Overall Reference Architecture (NORA) – Handbook
S/No Activity Description
1. Identify usage
plan direction
•	 Identify EA usage cases from the EA best practices and
trends
•	 Identify EA usage types based on EA requirements and
the result of best practices analysis
2. Identify usage
scenario
•	 Identify EA usage scenario from best practices and trends
•	 EA usage scenario can be developed by merging of use
cases and identifying of EA requirements
3. Define EA usage
plan policy or
regulation
•	 Draft the relevant policies or regulations
•	 Review and obtain feedback; carry out relevant updates
•	 Obtain EA Governance Committee approval
Table ‎5-7: Activities to define EA usage plan
Figure ‎5-3: Example for EA usage direction
84
National Overall Reference Architecture (NORA) – Handbook
2. EA Management Direction
Although some of the EA requirements were gathered in the early stages of the EA develop-
ment, it is a good governance practice to review and update these requirements. The EA Gov-
ernance Committee has to set clear management directions for both the development of the
EA, and the implementation of the EA. The purpose of this activity is to define EA management
direction by referring to agency’s EA requirements, EA architecture principles, EA usage plan
and the developed artifacts.
Setting the main management directions require comprehensive information from trends
analysis and new technologies including considerations for political and social factors. The EA
Governance Committee has to consider all other governance aspects such as change and per-
formance management, in defining necessary policies or regulations on the EA management
direction. Below are descriptions to define the management direction and examples. Note that
the actual EA management plan will be drafted in Stage 9.
S/
No
Activity Description
1. Identify EA management
plan direction
•	 Identify EA management plan cases from the EA
best practices and trends
•	 Identify considerations of EA management plan in EA
principle, purpose, and scope
2. Identify environmental
analysis & requirements
•	 Identify architecture requirements from IT trends analysis
and agency’s strategy information in environmental analy-
sis results
•	 Identify architecture development scope by each area
•	 Identify EAMS operating information
•	 Identify information which EA management plan needs
to support in EA usage plan development
•	 Identify the key consideration for EA management plan
3 Define EA management
policy or regulation
•	 Draft the relevant policies or regulations
•	 Review and obtain feedback; carry out relevant updates
•	 Obtain EA Governance Committee approval
Table ‎5-8: Activities to define EA management plan
85
National Overall Reference Architecture (NORA) – Handbook
Figure ‎5-4: Example for EA management plan direction
3. Compliance Policies
The EA Core and working teams have to draft relevant policies, regulations or direction state-
ments to ensure that the various parties or divisions in the government agency will use and
comply with EA standards and guidelines. All the policies or direction statements will require
review and approval by the EA Governance Committee. It is also important to ensure that these
policies are clearly communicated to all parties in the government agency.
5.4.5 Performance management
As a strategic enabler, EA provides the ability to define and measure performance of the gov-
ernment agency. While this can be incorporated into the Performance Architecture (which is
optional), the execution of EA nonetheless requires performance metrics to be defined so that
management knows whether the EA project has been a success.
The performance metrics have to be aligned with the Saudi e-Government Action Plan and the
government agency’s strategies and plans. Corporate score cards, national government and
local government indexes can be used to derive the key performance indicators (PKIs). The
performance metrics should also be use in the strategic planning by the government agency. An
example of a performance metric is in Table 5-7.
86
National Overall Reference Architecture (NORA) – Handbook
S/No KPIs Target
Not
Performing
Under
Performing
Performing
A Strategic Planning
1 Alignment to Saudi e-Govern-
ment Action Plan
90% Less than
70%
Less than 90% Meet or Exceed
90%
2 Incorporate Government
Agency’s Strategies & Plans
95% Less than
70%
Less than 95% Meet or Exceed
95%
B Drive out Duplications of ICT Investments
3 Improve business processes
(through BPR or reviews)
5 business
processes
0 -2 3 Meet or Exceed
5
4 Use National Shared Applications 2 Applications   0 1 Meet or Exceed
2
5 Share Data with Government
Agencies (Give or Receive)
5 Data
Sources
0 -1 3 or less Meet or Exceed
5
6 Remove or Replace Applications
with Obsolete Technologies
75% Removal
or Replaced
by year XXXX
Less than
50%
Less than 75% Meet or Exceed
75%
C Increase Indirect Value of Government ICT Investments
7 Use National ICT Infrastructure
or Initiatives where possible
4 National ICT
Infrastructure
0 - 2 3 Meet or Exceed
4
8 Use Government Agency-Wide
Application Framework &
Components (promote re-usable
services)
5 Application
Components
0 - 2 3 Meet or Exceed
5
9 Transform manual communica-
tions within and among govern-
ment agencies into electronic
95% Less than
50%
Less than 75% Meet or Exceed
95%
D Contribute to the Establishment of Information Society in KSA
10 Deliver services and information
electronically
95% Less than
50%
Less than 75% Meet or Exceed
95%
11 Transform manual communications
with public into electronic
90% Less than
50%
Less than 70% Meet or Exceed
90%
Table ‎5-9: Performance metrics example
87
National Overall Reference Architecture (NORA) – Handbook
Stage3–Analyze
CurrentState
88
National Overall Reference Architecture (NORA) – Handbook

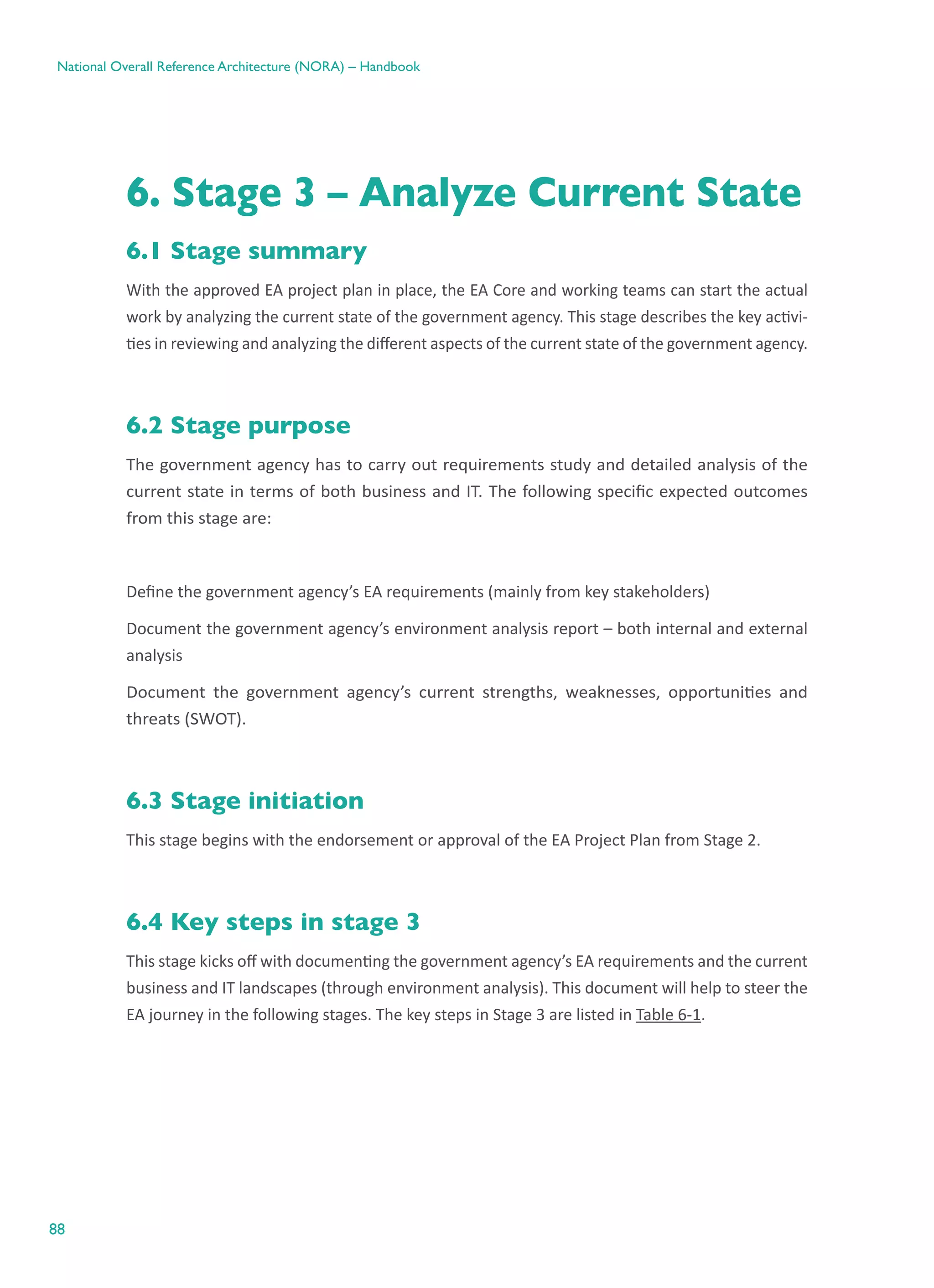

6. Stage 3 – Analyze Current State
6.1 Stage summary
With the approved EA project plan in place, the EA Core and working teams can start the actual
work by analyzing the current state of the government agency. This stage describes the key activi-
ties in reviewing and analyzing the different aspects of the current state of the government agency.
6.2 Stage purpose
The government agency has to carry out requirements study and detailed analysis of the
current state in terms of both business and IT. The following specific expected outcomes
from this stage are:
Define the government agency’s EA requirements (mainly from key stakeholders)
Document the government agency’s environment analysis report – both internal and external
analysis
Document the government agency’s current strengths, weaknesses, opportunities and
threats (SWOT).
6.3 Stage initiation
This stage begins with the endorsement or approval of the EA Project Plan from Stage 2.
6.4 Key steps in stage 3
This stage kicks off with documenting the government agency’s EA requirements and the current
business and IT landscapes (through environment analysis). This document will help to steer the
EA journey in the following stages. The key steps in Stage 3 are listed in Table 6-1.
89

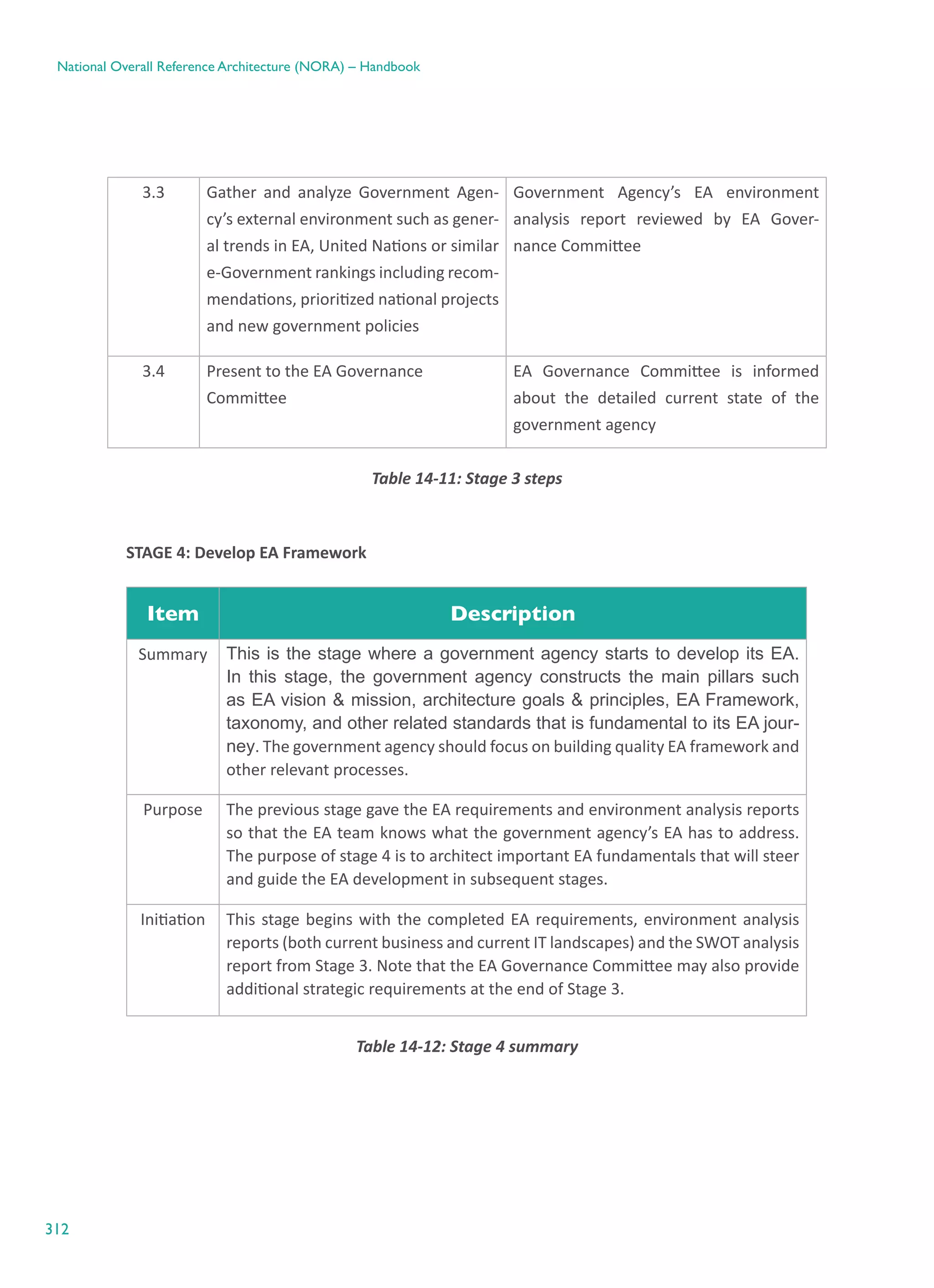

National Overall Reference Architecture (NORA) – Handbook
Stage /
Step No
Description Deliverable
3 Analyze Current Stage a.	 EA Requirements
b.	 EA Environment Analysis Reports
(Current Business Landscape and
Current IT Landscape)
c.	 SWOT Analysis Report
3.1 Gather and document EA require-
ments from various stakeholders
such as e-Transformation Commit-
tee, EA Governance Committee,
main business functions’ stakehold-
ers, and EA working teams
Government Agency’s EA requirements
reviewed by EA Governance Committee
3.2 Gather and analyze Government
Agency’s internal environment such
as organizational capability to plan
and execute e-transformation plan,
business plan and IT plan
Government Agency’s EA environment
analysis report reviewed by EA Gover-
nance Committee
3.3 Gather and analyze Government
Agency’s external environment
such as general trends in EA, United
Nations or similar e-Government
rankings including recommenda-
tions, prioritized national projects
and new government policies
Government Agency’s EA environment
analysis report reviewed by EA
Governance Committee
3.4 Present to the EA Governance Com-
mittee
EA Governance Committee is informed
about the detailed current state of the
government agency
Table ‎6-1: Stage 3 steps
90
National Overall Reference Architecture (NORA) – Handbook
6.4.1 Step 3.1 Gather and document EA requirements
Like any big and complex project, it is important to get clear requirements. In Stage 1, the EA was
introduced to the government agency and basic requirements or directions were obtained. In this
stage, more detailed requirements have to be gathered from different stakeholders in the govern-
ment agency.
Getting and documenting the EA requirements require a number of activities. The following
progressive set of activities are recommended:
1.	 Plan the type of information required and from which stakeholders
2.	 Prepare another round of awareness sessions on EA to the stakeholders including those in
middle management and even operations staff
3.	 Design a set of questionnaire to capture basic requirements on common problems in the gov-
ernment agency (this output is useful not only for EA but for other organizational and IT im-
provements); this questionnaire can be manual or preferably in electronic version (please see
Table 6-2 for example)
4.	 Conduct the EA awareness sessions and send out the questionnaire
5.	 Review and analyze the questionnaire’s responses; and document the main findings
6.	 From the main findings, the team can start to interview key stakeholders to verify these
findings and to obtain more requirements. Please refer to Table 6-3 for example format of
documenting the stakeholders’ requirements. The recommended stakeholders would be:
        a. IT infrastructure team such as network, helpdesk and IT support teams
        b. Data teams such as IT DBA and owners of data (if available)
        c. IT application development team such as IT Manager and Application Analyst
        d. Application and e-service Owners (business staff)
        e. CIO and top management.
7.	 Document the final EA requirements and present to the EA Governance Committee.
91
National Overall Reference Architecture (NORA) – Handbook
Question
Areas
Example Questions
Organization a.	 Is there a clear vision and mission for the government agency?
b.	 Are staff aware of the government agency’s plans (business, IT, etc.)?
c.	 Is there a mandate on the goals of e-transformation plan for the gov-
ernment agency from its management?
d.	 How would they rate the government agency’s capability to manage
influences and factors caused by external factors such as economic
changes, politics, social impacts, environmental demands and technology
innovations?
e.	 Are there quality standards or key performance indicators defined for
the government agency?
Business
Performance
a.	 Are the various business functions and business services measured?
b. And are they aligned with the government agency’s quality standards
or KPIs?
c.	 What are the key issues faced by the business functions?
e.	 How are business functions’ challenges and problems being ad-
dressed? In particular, how to resolve inter-department or inter-divi-
sion issues?
Application /
Solutions
a.	 Who decides the need for an application / solution automation?
b.	 Who budgets or funds for the development of these applications /
solutions?
c.	 Are there are standards for developing or choosing an application /
solution (including the platform such as mobile, stand-alone, web-
based, etc.)?
d.	 Are the applications / solutions shared across divisions or departments?
e.	 Does the government agency access other government agencies’ ap-
plications? If yes, please collect the list of applications / solutions
f.	 Is there a standard authentication mechanism to access the various
applications / solutions?
92
National Overall Reference Architecture (NORA) – Handbook

Data / Information a. Who decides on the ownership of data?
b. Is data or information being shared within the government agency
across the divisions, departments and branches?
c. Are there any data shared with the citizens, business or other government
agencies? If yes, please list the data
d. Are there any data duplications in the government agency?
e. Are there incidents of lost or stolen data?
IT Infrastructure a.	 Is there a shared network within the government agency?
b.	 Is there government agency connected to the Saudi Government
Network?
c.	 Can staff access internet?
d.	 Are staff given a PC or digital device?
e.	 Is office automation (email, e-documentation) a common practice in
the government agency?
f.	 Are there security measures to protect the IT infrastructure?
Table ‎6-2: Example questionnaire
Stakeholders
What
(Data or
Information)
How
(Things to
be done)
Why
(Reason)
Where
(Things to
be done)
Who
(To carry
out)
When
(To carry
out)
Top
Management
Business Owners
Data Owners
Application
Developers
IT Infrastructure
EA Core Team
Table ‎6-3: Example format to gather EA requirements
93
National Overall Reference Architecture (NORA) – Handbook
6.4.2 Step 3.2 Analyze internal environment
While the previous step gives the EA working team a very good idea about the EA require-
ments, the team has to also understand where does the government agency stand in terms
of its organization’s EA maturity & capability. Thus, both an internal and external environment
analysis have to be carried out. Start by reviewing the documents prepared in Stage 1 - relevant
EA trends and case studies relating to the government agency, and the government agency’s
e-transformation maturity.
The basic idea of internal environment analysis is to know the maturity level of the government
agency from an internal perspective – both from an organization and IT areas. This information
would help shape the EA outcomes in the next few stages. The outputs from Stage 1 have to be
reviewed and understood.  A more detailed analysis is now required as summarized in Table 6-4.
Analysis Area Analysis Measurement Expected Outcomes
Organizational Review Vision and Mission Alignment Identify gaps in mission/vision
& objectives
Business Functions / Tasks Identify gaps or misalignment
of tasks to overall objectives
IT Review Business and IT Alignment Identify gaps or misalignment
of applications to business
IT Standards IT interoperability issues
Table ‎6-4: Internal analysis areas & expected outcomes
94
National Overall Reference Architecture (NORA) – Handbook
Organizational Review
In this review, the team has to carry out 2 measurements – vision and mission alignment and
how the business functions or tasks support the overall goals or objectives. For both measure-
ments, the analysis is based on the government agency’s organization chart including its vision,
mission and objective statements. For a start, the team must obtain these latest organizational
information.
1.Vision and Mission Alignment
a.	 This measurement is to answer the strategic question i.e. are all business units in the govern-
ment agency aligned to its overall vision, mission and objectives?
b.	 Check and evaluate the vision and mission statements; thus the teams need to really under-
stand what exactly the government agency is set up to do
c.	 Find out if the various departments or divisions or branches have their own vision and mis-
sion statements; ensure that they are aligned to the main statements. Sometimes, a division
or department embarks on its own set of vision and mission statements that do not align to
the government agency’s main vision and mission statements
d.	 Analyze how the government agency’s broad objectives are supported by the various de-
partments and divisions. It may be common that these objectives may be directed to more
than one department or division
e.	 Refer to the government agency’s action plan or roadmap; this would help to understand
and map the activities
f.	 Document the abnormalities or gaps among the goals and objectives and how they are not
directly mapped to the departments and divisions (if any).
g.	 Capture ‘Agency E-transformation plan’ and ‘Objectives’ related to agency for the National
Data Gathering as shown in the annex C(NEA Meta-Model)
95
National Overall Reference Architecture (NORA) – Handbook
Figure ‎6-1: Example of Vision/Mission alignment with goals and initiatives
2. Business Functions / Tasks
a.	 This measurement is to answer the strategic question i.e. are all business functions / tasks
clearly defined and executed or are there grey areas and unclear business functions / tasks?
b.	 Similarly like above, find out how government agency’s objectives and goals are mapped to
the different functions / tasks
c.	 Please see Figure 6-1 as an example
d.	 For e.g. Goal 3 would have Strategy 2 and followed by Initiative 3; this initiative has to be
mapped to a business function / task and then to a department or division
e.	 Document those that are not properly mapped or unclear or with duplicates.
96
National Overall Reference Architecture (NORA) – Handbook
IT Review
In this review, the team has to carry out two measurements – business and IT alignment, and
the IT standards. It would be good if the government agency can document its IT landscape
(i.e. a detailed description and inventories of all the IT-related assets, systems. applications and
data). Other useful sources of information include IT Portfolio if available. If none of these are
available, the IT teams have to use whatever inventories they have.  For a start, please carry
out an update on all the IT inventory to get the latest information. The following figures are
examples of the IT review outcomes.
1. Business and IT Alignment
a.	 This measurement is to answer the strategic question i.e. are the core business functions of
the government agency effective and being supported by IT automation?
b.	 Review the IT Plan of the government agency; for each major IT project or application sys-
tem, analyze to see if it supports a business function or task
c.	 Similarly review the data used in the government agency; for each data entity type (for e.g.
Citizen, Employment and Government Agency), check how the business functions and tasks
utilize it – either Read, Write, Update or None at all. Also check for data duplications
d.	 Another perspective is to sort all the IT systems and data by the various business functions;
from here, it is easy to analyze which business functions have the highest rate of IT adoption
e.	 Document these findings and analysis.
f.	 Capture the IT Project related information for National Data Gathering as shown in the annex
C(NEA Meta-Model).
97
National Overall Reference Architecture (NORA) – Handbook
Division Name/Department Name
Division Name/Department Name
Division Name/Department Name
Systems
Independently
Implemented &
Operated
Separate information
systems,..etc
Data Duplication
Clients information
duplications,
Services information
discrepancies across
divisions,.. etc
Government
Dynamic Directions
New services
Requested,..etc
Duplicated
Information
Complicated
Linkage
Structure
DB1
CRM Purchasing Inventory
DB2DB2
Division Name/Application Owner
Purchasing System
Inventory System
Correspondence System
Duplication Examples
Date Set A
Date Set B
Date Set B
Date Set B
Date Set B
Date Set B
Date Set B
IT Status -Core Issues & Problems
Figure ‎6-2: Example of business and IT alignment
98
National Overall Reference Architecture (NORA) – Handbook
Figure ‎6-3: Example of major IT systems supporting government functions
99
National Overall Reference Architecture (NORA) – Handbook
Figure ‎6-4: Example of IT systems supporting government functions by business areas
2. IT Standards
a.	 This measurement is to answer the strategic question i.e. how pervasive is the use of IT in
the government agency, and does the IT adoption comply with specific standards?
b.	 The teams have to analyze a few key IT areas such as infrastructure, data, applications and
e-services
c.	 For infrastructure, areas of measurement include network penetration (i.e. how much net-
work has been installed in the government agency, and the network utilization), IT devices
adoption rate, maturity of data center, and servers & storage
d.	 Database standards, data definitions and data exchange methods are to be analyzed
e.	 For applications, the teams have to review the application development standards, application
platform standards, application testing and deployment to name a few
f.	 Last but not least, review the standards used to design, develop and deploy e-services (not
that the measurement of e-services maturity can be obtained from Yesser)
g.	 Consolidate and document the IT Standards measurements.
100
National Overall Reference Architecture (NORA) – Handbook

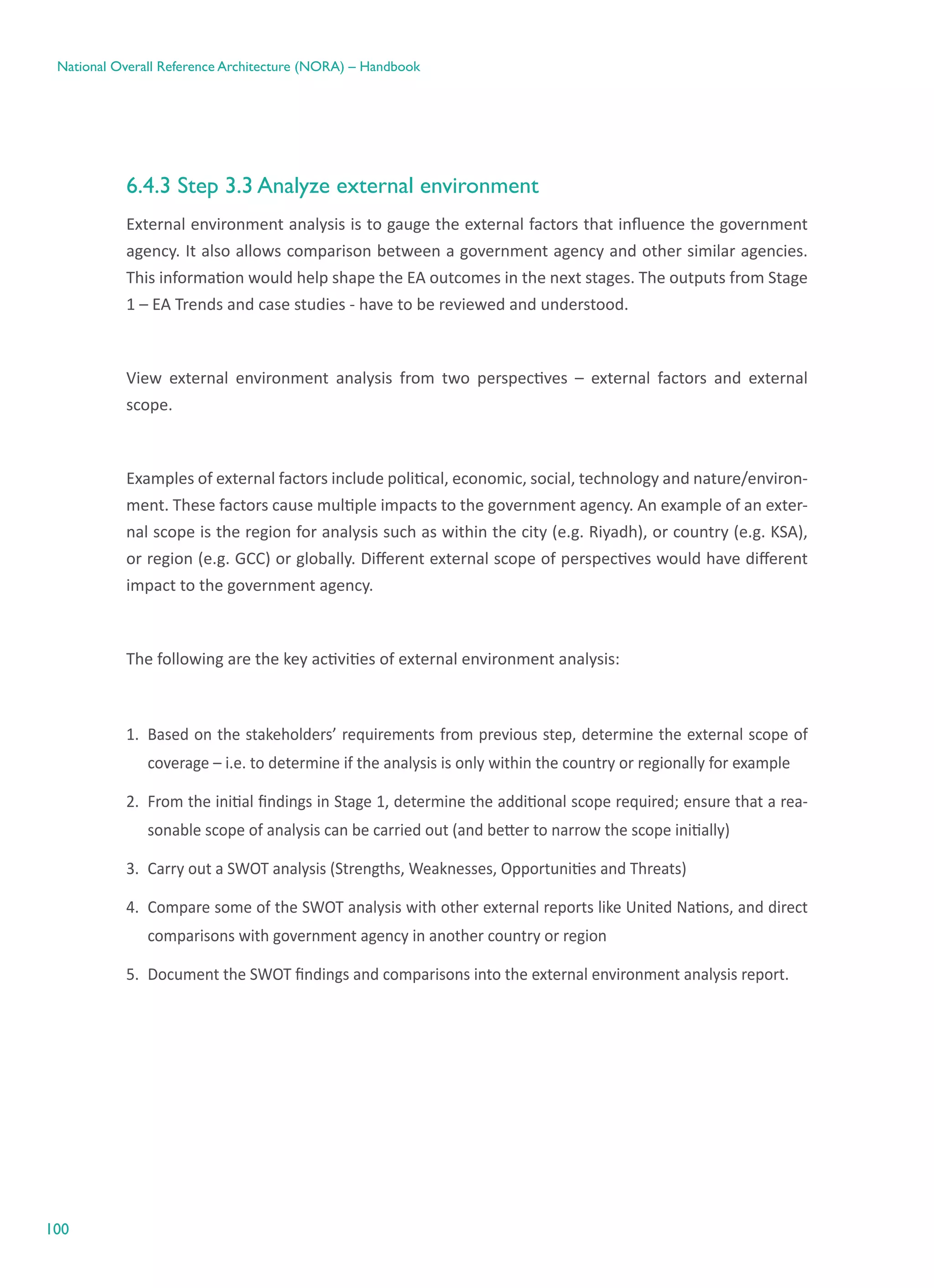

6.4.3 Step 3.3 Analyze external environment
External environment analysis is to gauge the external factors that influence the government
agency. It also allows comparison between a government agency and other similar agencies.
This information would help shape the EA outcomes in the next stages. The outputs from Stage
1 – EA Trends and case studies - have to be reviewed and understood.
View external environment analysis from two perspectives – external factors and external
scope.
Examples of external factors include political, economic, social, technology and nature/environ-
ment. These factors cause multiple impacts to the government agency. An example of an exter-
nal scope is the region for analysis such as within the city (e.g. Riyadh), or country (e.g. KSA),
or region (e.g. GCC) or globally. Different external scope of perspectives would have different
impact to the government agency.
The following are the key activities of external environment analysis:
1.	 Based on the stakeholders’ requirements from previous step, determine the external scope of
coverage – i.e. to determine if the analysis is only within the country or regionally for example
2.	 From the initial findings in Stage 1, determine the additional scope required; ensure that a rea-
sonable scope of analysis can be carried out (and better to narrow the scope initially)
3.	 Carry out a SWOT analysis (Strengths, Weaknesses, Opportunities and Threats)
4.	 Compare some of the SWOT analysis with other external reports like United Nations, and direct
comparisons with government agency in another country or region
5.	 Document the SWOT findings and comparisons into the external environment analysis report.
101
National Overall Reference Architecture (NORA) – Handbook
Table 6-5 is an example of a SWOT Chart Template.
SWOT Chart Template
•	 Strengths:
•	 What the government agency does well in?
•	 What unique resources and capabilities can
the government agency draw on?
•	 What advantages does the government
agency have?
•	 What do citizens and businesses see as the
government agency’s strengths?
•	 Weaknesses
•	 What could the government agency
improve on?
•	 What should the government agency
avoid?
•	 What do citizens and businesses see as
the government agency’s weaknesses?
•	 Opportunities
•	 What promising options are open to the
government agency?
•	 What are the interesting trends the govern-
ment agency is aware o government f?
•	 How can the government agency convert its
strengths into opportunities?
•	 Threats
•	 What obstacles does the government
agency face?
•	 What trends could hinder the govern-
ment agency?
•	 What are other government agencies
doing?
•	 Are the required specifications for the
services provided by the government
agency changing?
•	 Is changing technology threatening the
government agency?
•	 Could any your weaknesses seriously
threaten the operation of the govern-
ment agency?
Table ‎6-5: SWOT chart template
At the end of this stage, the EA requirements together with the environment analysis reports
would help the EA Core team to understand how the government agency’s EA can help to resolve
these issues and meet the requirements.
102
National Overall Reference Architecture (NORA) – Handbook
6.4.4 Step 3.4 Present current state analysis
Present these findings of the government agency’s current state to the EA Governance Committee for
information and comment. Through this presentation, the governance committee is aware of the
current challenges, issues, threats and even possible opportunities. From their collective wisdom,
the EA Governance Committee can provide strategic directions for subsequent EA development.
If required, the EA Governance Committee may also want these findings to be presented to the
e-Transformation Committee or equivalent.
103
National Overall Reference Architecture (NORA) – Handbook
Stage4–Develop
EAFramework
104
National Overall Reference Architecture (NORA) – Handbook
7. Stage 4 – Develop EA
Framework
7.1 Stage summary
This is the stage where a government agency starts to develop its EA. In this stage, the government
agency constructs the main pillars such as EA vision & mission, architecture goals & principles, EA
Framework, taxonomy, and other related standards that is fundamental to its EA journey. The gov-
ernment agency should focus on building quality EA framework and other relevant processes.
If I had 8 hours to chop down a tree, I’d spend 6 hours sharpening my axe “
~ Abraham Lincoln
7.2 Stage purpose
The previous stage gave the EA requirements and environment analysis reports so that the EA
Core team knows what the government agency’s EA has to address. The purpose of stage 4 is
to architect important EA fundamentals that will steer and guide the EA development in subse-
quent stages. The following specific expected outcomes from this stage are:
1.	 Define the government agency’s EA vision, mission, architecture goals and architecture principles
2.	 Define EA documentation standard
3.	 Define EA artifact review and approval process
4.	 Create the government agency’s EA Framework.
105
National Overall Reference Architecture (NORA) – Handbook
7.3 Stage initiation
This stage begins with the completed EA requirements, environment analysis reports (both current
business and current IT landscapes) and the SWOT analysis report from Stage 3. Note that the
EA Governance Committee may also provide additional strategic requirements at the end of
Stage 3.
7.4 Key steps in stage 4
Stage 4 focuses on high level architecture activities that require experience and vision. The key
steps in Stage 4 are listed in Table 7-1.
Stage /
Step No
Description Deliverable
4 Develop EA Framework 1.	 Government Agency’s EA Mission,
Vision, Architecture Objectives and
Architecture Principle Statements
2.	 Government Agency’s EA Framework
4.1 Define EA’s vision and mission state-
ments, & architecture objectives
Draft EA Vision, Mission, , and
architecture objectives
4.2 Define EA’s architecture principles Draft EA Principles
4.3 Present and obtain approval for EA vi-
sion, mission and architecture objectives
Approved EA Vision, Mission, Architecture
Objectives and Architecture Principles
4.4 Define EA Framework structure Draft EA Framework Structure
4.5 Design EA architecture elements Draft EA Architecture Elements
4.6 Design EA model Draft EA Model
4.7 Develop EA documentation standard EA documentation standard
4.8 Develop EA artifacts management
processes
Draft EA Artifact management processes
4.9 Present and obtain approval for EA
framework
Approved EA Framework
Table ‎7-1: Stage 4 steps
106
National Overall Reference Architecture (NORA) – Handbook

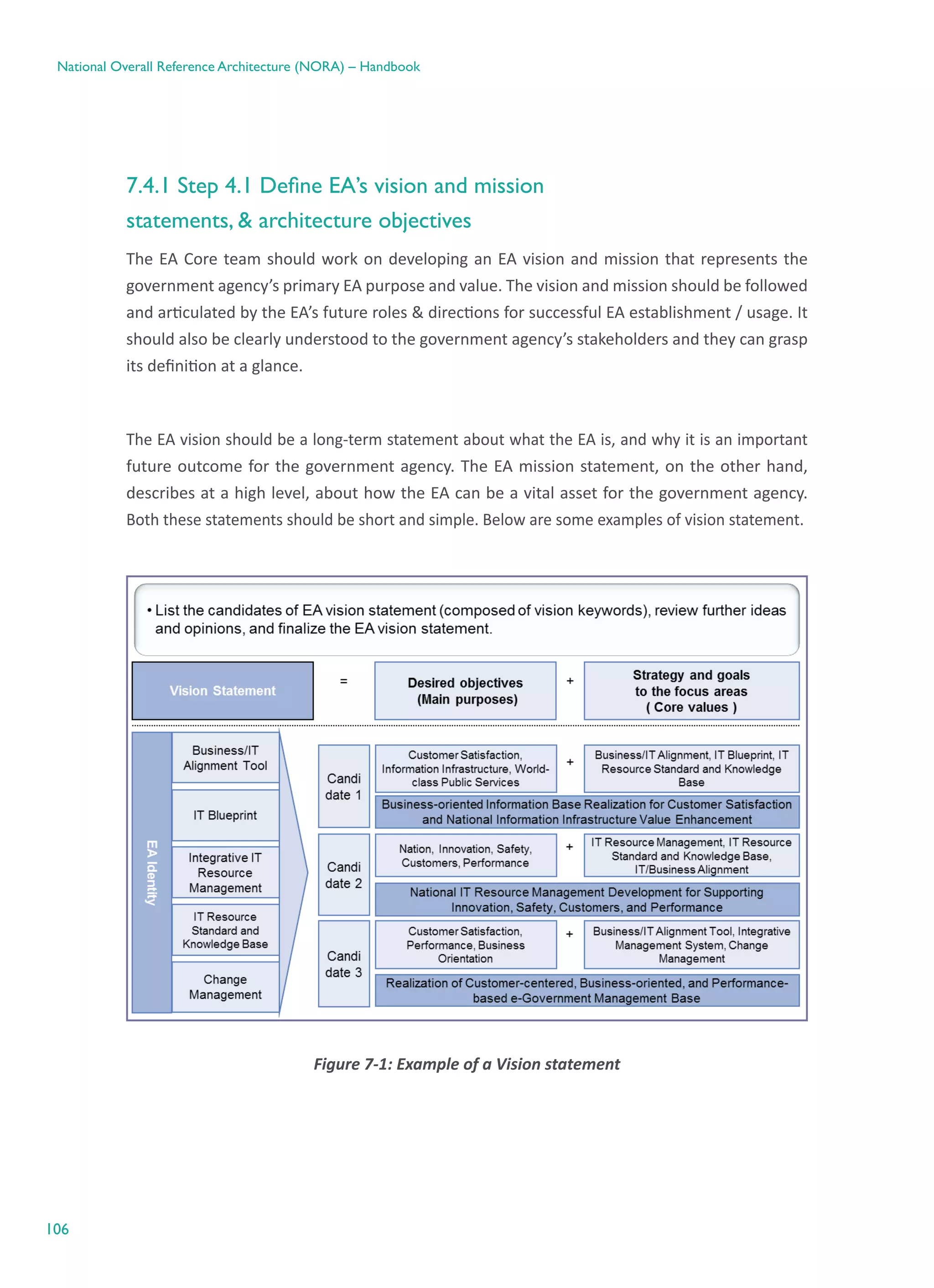

7.4.1 Step 4.1 Define EA’s vision and mission
statements, & architecture objectives
The EA Core team should work on developing an EA vision and mission that represents the
government agency’s primary EA purpose and value. The vision and mission should be followed
and articulated by the EA’s future roles & directions for successful EA establishment / usage. It
should also be clearly understood to the government agency’s stakeholders and they can grasp
its definition at a glance.
The EA vision should be a long-term statement about what the EA is, and why it is an important
future outcome for the government agency. The EA mission statement, on the other hand,
describes at a high level, about how the EA can be a vital asset for the government agency.
Both these statements should be short and simple. Below are some examples of vision statement.
Figure ‎7-1: Example of a Vision statement
107
National Overall Reference Architecture (NORA) – Handbook
The following activities are recommended for the EA Vision and Mission statement development:
1.	 From the EA requirements and environment analysis reports, shortlist key words that help to
shape the future EA. Examples are words such as performance-driven, agile government, effec-
tive decision making, business-IT alignment, IT investments, and  citizen-centric services
2.	Review the government agency’s vision and mission statements, and extract key words that
affect the EA development
3.	Check for the IT vision and mission statements (if any). If available, extract key words that
match with the shortlisted key words above
4.	Consolidate all the key words for the vision and mission statements
5.	Conduct a brainstorming session among the EA Governance Committee and EA working
teams to define the vision and mission statements
6.	Define the architecture objectives of the EA based on the vision and mission statements
7.	The team may also want to get feedback from other stakeholders such as specific business
divisions and even the top management. Update these statements from their feedback
8.	Table 7-2 is a guideline on the considerations for effective vision and mission statements.
108
National Overall Reference Architecture (NORA) – Handbook
Area Consideration
Understandability
•	 A vision and mission statement should be clearly understood and
promptly captured by EA stakeholders
•	 Definitions and use of certain terms within the agency can increase
understandability
Solidity
•	 Consider the missions, values, and directions that the current government
and e-Government program are pursuing
•	 An EA vision / mission statement that is linked to agency’s established
values can easily convince  internal EA stakeholders
Consensus
•	 An EA vision / mission statement should be created based on all stake-
holders’ consensus and awareness
•	 An EA vision / mission should be agreed upon and recognized within
an agency to be successful
Alignment
•	 All architectural areas should be aligned with a given EA vision because
EA vision is a guide that directs other elements such as EA purposes,
principles, and framework.  This makes an EA consistent and unified
Usability
•	 EA vision / mission should be connected to agency’s business purposes
in order for EA to be used in various business processes
•	 Consider how to realize EA vision / mission in each area of an agency
(Organization, H/R, Businesses, etc), and adjust EA management and
evaluation process
Table ‎7-2: Considerations for effective Vision & Mission statements
109
National Overall Reference Architecture (NORA) – Handbook
7.4.2 Step 4.2 Define EA’s architecture principles
With the government agency’s vision, mission and architecture objectives defined, the next
activity is for the EA Core team to rationalize the architecture principles. While this may sound
easy, the definition of these principles should be deeply analyzed and reviewed as it affects
the EA development. Architecture principles are statements about high level rules and strict
guidelines to shape and steer the development and maintenance of the government agency’s
EA. These principles would aid decision making and even architecture designs of the various
components in the EA. More importantly, these architecture principles reflect a level of con-
sensus on how architecture elements should be abstracted, integrated and used to develop the
future or target architectures, and eventually how stakeholders can appreciate the values or
outcomes of EA.
Table 7-3 are some recommended criteria for the development of good or acceptable architec-
ture principles.
Criteria Description
Easy to Understand The architecture principle should be easy to understand by any person
Completeness The architecture principle should be comprehensive in coverage.
Typically it would cover both IT and business aspects
Consistency The architecture principle should be applied to consistently to all
aspects of EA development. It should consistent in its application
to all architectures or reference models
Robust The architecture principle should be robust to changing environ-
ments and circumstances.  While there are constant changes like
politics, technologies and social demands, the architecture prin-
ciple should be able to endure these factors and continue to be
relevant
Table ‎7-3: Criteria examples of good architecture principles
110
National Overall Reference Architecture (NORA) – Handbook
Figure 7-2 illustrates how EA principles are derived from the EA purpose or value proposition
statements.
Figure ‎7-2: Example of EA architecture principles
The following are the recommended factors for consideration in developing the EA architecture
principles:
1.	The EA vision and mission statements, and the architecture objectives should drive the
architecture principles
2.	Alternatively, the EA purpose or value-proposition statements can also be used to derive the
architecture principles
3.	Refer to other EA frameworks as examples; also refer to NEA architecture principles
4.	Brainstorm for the relevant EA architecture principles to aid the EA development and main-
tenance. The Enterprise Architect should lead the session
5.	Prioritize and document these principles; preferably not more than seven principles.
111
National Overall Reference Architecture (NORA) – Handbook
7.4.3 Step 4.3 Present and obtain approval for EA vision, mission and ar-
chitecture objectives
Present the EA vision and mission statements, architecture objectives and architecture principles
to the EA Governance Committee. As these are very high-level statements, expect comments
from the committee and the need to enhance them to get a final approval.
7.4.4 Step 4.4 Define EA Framework structure
The next step is to define an EA Framework structure that outlines the overall ‘look’ of the EA. It
describes the boundaries of the EA for the government agency based on the vision and mission
statements, architecture objectives and architecture principles that shape the development of
the EA. An EA Framework is a structure used for organizing EA elements and their relationships.
The EA Framework is used to design and develop the actual government agency’s EA and other
reference models.
The key activities to develop an EA Framework structure are:
1.	Analyze the related trends and case studies for EA for similar government line of business
or function (see Table 7-4 as an example). This could be both external and local government
agencies. Look at their EA frameworks or conceptual architecture diagrams
2.	Also refer to NEA and other government agencies’ EA frameworks
3.	Analyze each component in the example EA frameworks and take the relevant components
4.	Design the high level based on the need to have the relevant components
5.	Review and enhance the EA Framework (this is an iterative process).
112
National Overall Reference Architecture (NORA) – Handbook
Research Item Description
National EA Frame-
work Standard
Provide frameworks and guidelines required for EA development by
identifying, organizing national EA framework elements and setting
relationships between them
EA Demonstration
Project
Agencies’ EA demonstration projects for EA implementation
(Ministry of Information and Communication, Ministry of Govern-
ment Administration and Home Affairs, Public Procurement Service,
Ministry of Maritime Affairs and Fisheries)
Overseas Case
Overseas framework cases
(FEAF: established and construct reference models   according to
OMB guideline
TEAF: define elements such as architecture framework, governance,
process, etc.
DOI: the U. S. interior department’s framework)
Table ‎7-4: Examples of research areas for EA Framework
Figure 7-3 is an example of an EA Framework structure. Government agencies need not follow all
of the architectures in the example but the relevant ones to meet the overall EA strategy. Some
of the architectures in the example can be added (for example Service Architecture and Process
Architecture) or can be replaced (such as Information Architecture instead of Data Architecture).
113
National Overall Reference Architecture (NORA) – Handbook
Figure ‎7-3: EA Framework structure example
7.4.5 Step 4.5 Design EA architecture elements
With the high level EA Framework structure, the EA Core team can start identifying and defin-
ing architecture elements within each architecture boundary. By referring to other related EAs,
the EA Core team can make logical relationships and deductions. As the EA Framework has also
already established a “Big Box”, this step is to fill the elements within each architecture. These
elements will also be the main artifacts – i.e. documents that are created, designed and main-
tained as part of EA.
The recommended architecture elements are listed below in Table 7-5. The EA Core team can
add or remove these elements on a need basis. For each of the following elements, the EA Core
team lead by the Chief Architect have to rationalize and describe the architecture elements.
Note that this is an iterative process and requires a series of brainstorming and review sessions.
114
National Overall Reference Architecture (NORA) – Handbook
S/
No
Element or Artifact Definition
1 Principles Describe the architecture principles of the
particular architecture; it has to have more
than 1 principle
2 Architecture Element Describe the relevant architecture elements
of the particular architecture; it can 1 or
more elements
3 Rules and Standards Describe the important rules and standards
in developing the architecture; it supports
the principles established above
4 Components Describe the components that are related to
the architecture elements; typically one archi-
tecture element has one or more components
5 Domains Describe the area or scope of architecture
implication; typically related to technology
domains, each architecture may have 0, 1
or more domains
6 Patterns Describe or illustrate, normally in diagrams,
the main architecture patterns that is useful to
further develop the actual reference model;
typically each architecture has at least one
pattern
7 Building Blocks Describe how the relevant elements can be
pieced together; it shows the dependency if any
Table ‎7-5: Description of EA elements
7.4.6 Step 4.6 Design EA model
Having designed the high level EA Framework structure and its architecture elements, the EA
Core team has to design the EA Model that is express as a matrix classifying all resources from
different views or perspectives. For now, the EA Model is a high-level classification of views and
key architectural elements. Subsequently in the EA development, the EA Core team will use this
model to develop further detailed reference models.
The purpose of the EA Model definition is to establish current / target architecture and a basic
system for the management and application of the EA.
115
National Overall Reference Architecture (NORA) – Handbook
S/No Task Method Deliverable
1. Define architecture
model’s view and
perspective for
registering, using,
managing EA
information
a.	 Perspective definition
b.	 Perspective or viewpoint is divided
by a role of EA stakeholders such as
CEO, CIO, IT Manager, Architect and
IT Developer or Vendor
c.	 Perspective classifies agency’s
decision-makings with a hierarchical
structure and defines the stages by a
decision-making characteristic
d.	 Perspective is defined by roles, not
by level or positionAt first, define
Perspective by using typical clas-
sification, and adjust categories or
vocabularies to fit agency’s needs.
EA Model by Stake-
holder (see Table
7-7)
2. Define architec-
ture model’s view
and perspective
from stakehold-
ers’ functional
responsibilities
a.	View definition
b.	View is a standard for observing
architecture’s specific parts. In other
word, as to figure out an identical ar-
chitecture and, it’s divided by a type
of architectural resources
c.	View is largely divided into busi-
ness and technology. While the
business is divided into organiza-
tion, functions, and projects, the
technology is divided into data,
application, security, etc.
d.	In general, one view is taken by a
business, and several views are
taken by technology components
such as data, application, technol-
ogy, and security
e.	National EA framework standard
suggests five types of architecture
information ㅡ business, data, ap-
plication, technology and security.
EA Model by Archi-
tecture (see Table
7-8)
116
National Overall Reference Architecture (NORA) – Handbook
3. Define Artifacts
Meta-Model
a. Define all the key elements or
artifacts
b. Define the attributes of these ele-
ments or artifacts
c. Define relationships among ele-
ments or artifacts
d. Please refer to NEA Meta-Model
Draft EA Frame-
work with Artifacts
Meta-Model
4. Define Artifacts’
Elements
a. Define the actual elements and arti-
facts
b. Define the actual attributes
c. Define the actual relationships among
the elements or artifacts
Draft EA Frame-
work with Artifacts
and Elements Defi-
nitions
Table ‎7-6: Activities to develop the EA Model
Who Business Application Data Technology Security
CEO/CIO Deal with strategy, plan, overall process, key information, main infrastructure,
organizational chart
IT Manager Deal with business process, information, IT infrastructure
Architect Deal with logical business process design, logical information model, component/
application design, system dispersion/ deployment
IT Developer  / Vendor Deal with integration and tests with considering limitations to tools, technology,
and resources
Table ‎7-7: EA Model view by stakeholders
Who Business Application Data Technology Security
CEO/CIO Human
resources,
goods, places
and incidents
Business func-
tions, process and
activities
All necessary
information and
its relationships
Hardware,
software and
network
Secu-
rity policy or
structure
IT Manager
Architect
IT Developer
/ Vendor
Table ‎7-8: EA Model view by architecture
117
National Overall Reference Architecture (NORA) – Handbook
General Recommendations for DefiningViews and Artifacts
Make an architecture model best fitted with the government agency’s characteristics. Suggest
a list of documents and formats that each business / IT management department manage, and
use them.
In general, artifacts are constructed with a figure type or a description type. In case there are
figure type artifacts, check if description type artifacts are needed, and vice versa. Clearly define
artifacts with questions such as:
1.	Are specific use purposes for each artifact defined?
2.	What do artifacts establish?
3.	Why is the artifact required?
The following are recommended activities for defining Meta-Model Artifacts:
3. Elements definition
a.	Artifacts meta-model elements define each element for registering and managing artifacts
b.	Deduce elements based on agency’s EA Usage planning
c.	Deduce elements based on agency’s EA development purposes
d.	Deduce elements best fitted with agency’s EA requirements
e.	It’s advisable to delete easily changeable information from elements
f.	 Define elements by referring to ‘National EA Artifact Meta-model Definition’
g.	The agency should define compulsory items in ‘National EA Artifact Meta-model Definition’.
If not, the agency should do a mapping with the national EA items for government’s utiliza-
tion. Among the architecture information, consider the mandatory items of mandatory
artifacts that should be offered to national EA support system.
118
National Overall Reference Architecture (NORA) – Handbook
3.Attributes definition
a.	Define each element’ attributes
b.	Since they can be basic information of understanding elements, all required attributes
should be deduced for EA use
c.	It’s advisable to delete easily changeable information from attributes.
4. Define a relationship between elements
a.	Set a relationship by figuring out correlation between elements
b.	The relationship should be defined correctly since it can be a foundation of understanding
the relationship with other elements during artifacts registration / use.
The following are activities to define the artifacts / elements and their actual attributes:
1.Artifacts definition
i.	 With reference to EA purpose/ use, define required artifacts for using business/ IT information
by each view and perspective
ii.	 Define them by following mandatory artifacts suggested in ‘National EA Artifact Meta-mod-
el Definition’ in order to be offered to national EA support system
iii.	Define the artifact’s elements according to its definition and purposes
iv.	According to artifacts definition, agency’s artifacts definition, including artifacts definition,
purpose, description, templet, example, meta-model, etc., is written
v.	 Can use artifacts naming method to keep their consistency
vi.	In case required elements for each artifact are same, they can be integrated, defined as
one element
vii. Write agency’s artifacts definition with reference to National EA Artifact Meta-model
Definition’.
119
National Overall Reference Architecture (NORA) – Handbook
2. Define a relationship between artifacts
a.	Can define a relationship between artifacts by figuring out their attributes
b.	Identify the relationship by defining the relationship between elements
c.	Check how artifacts are aligned, especially between business and IT
d.	Through this step, can Identify missing or necessary relationships between elements and
add them.
7.4.7 Step 4.7 Develop EA documentation standard
To complete the whole EA Framework, it is a good practice to develop an EA Documentation
Standard. The objective is to ensure consistent quality in the production and maintenance of
EA artifacts and documents.
The following steps are recommended:
1.	Adopt the government agency’s standard documentation template; if this is not available,
then create one
2.	 Standardize on the written format such as page size, fonts, table-of-content, header & footer
and paragraphing (e.g. 1.5 line of space, full-justified)
3.	Standardize on EA and government agency’s terms and terminologies; Table 7-9 below is an
example of Yesser’s documentation standard for terms
4.	Standardize on the choice of tool to produce diagrams and figures (as EA will produce many
diagrams) such as Visio
5.	Standardize on the process for creating, updating, versioning, reviewing and approving these
artifacts and documents.
120
National Overall Reference Architecture (NORA) – Handbook
S/No Yesser Standard
Terms
Comment
1 e-Government Program (Yes-
ser)
Use the full terms for first definition in the documentation;
subsequently use ‘Yesser’
2 e-Government Describes general e-Government
3 e-service Describes general e-service
4 The 2nd
e-Government Action
Plan
The name of the current action plan for 2013-2017
5 e-transformation Describes the general transformation route from a traditional
government into an electronic government
6 YeFI Yesser Framework For Interoperability
7 e-Government National Portal The initiative for one standard government national portal
8 e-Government Data Center The initiative for a central government data center
9 Government Secure Network
(GSN)
The initiative for one government secure network
10 Government Service Bus (GSB) The initiative for government to exchange data and information
11 National Center for Digital
Certification
The initiative to implement national Pubic Key Infrastructure
(PKI)
12 Single Sign-On (SSO) The initiative to implement one standard authentication mech-
anism to access government services
13 SADAD Payment System (SA-
DAD in short)
The initiative to implement standard national billing and
payment system
14 e-Channel(s) Describes the method of interaction between service pro-
vider and consumer (e.g. Web, Mobile Application and Kiosk)
15 e-Training Describes interactive online training delivery
16 government agency Refers to the general government ministries, authorities,
boards, councils, etc.
Table ‎7-9: Example of Yesser’s standard terms
121
National Overall Reference Architecture (NORA) – Handbook
7.4.8 Step 4.8 Develop EA artifacts management processes
As there will be many artifacts and documents produced in the course of the EA development,
it is necessary to have a standard management process to review and approve the various
documents. Please refer to the section Continuous Governance – where the artifact process
management are describe as part of the EA overall change management – for more details.
The team needs to develop all the relevant artifacts management processes.
7.4.9 Step 4.9 Present and obtain approval for EA framework
With the completion of the EA Framework with the other above related contents, present to
the EA Governance Committee. The Chief Architect should front this presentation. From the
comments from the committee, make the necessary changes to obtain their final approval.
122
National Overall Reference Architecture (NORA) – Handbook
AboutReference
Models&Architectures
123
National Overall Reference Architecture (NORA) – Handbook
8. About Reference Models &
Architectures
8.1 Need for clarity
In the next few stages, the government agency will build reference models and architectures.
However, before building them, it is important to understand the differences among the vari-
ous reference models, current and target architectures. The EA Core team and working team
members have be clear about these deliverables and their respective objectives or purposes.
In addition, it would help to understand the relationships among these different deliverables.
8.2 Definitions
The following are the main definitions:
1. Reference Model
From The Open Group Architecture Foundation (TOGAF):
“A reference model is an abstract framework for understanding significant relationships among
the entities of [an] environment, and for the development of consistent standards or specifica-
tions supporting that environment. A reference model is based on a small number of unifying
concepts and may be used as a basis for education and explaining standards to a non-specialist.”
A reference model specifies standard classification and definition of common components used
for developing EA. EA reference model defines a set of standard representations and specifica-
tions to be use for developing EA, ensuring consistency, uniformity, and interoperability with
reference to NEA reference model.
In short, a reference model is use to describe, show and explain in general terms the main archi-
tectural elements or components so that different stakeholders can reference it to understand
and make relevant decisions that apply to their local context.
124
National Overall Reference Architecture (NORA) – Handbook
There are two main reference models in EA – NEA Reference Model and Government Agency
Reference Model.
2.Architecture
TOGAF defines an architecture as follows:
a	 A formal description of a system, or a detailed plan of the system at component level, to
guide its implementation (source: ISO/IEC 42010:2007).
b. 	The structure of components, their inter-relationships, and the principles and guidelines
governing their design and evolution over time.
In EA, the architecture describes the relevant elements or components from the reference
model, and further designs the details based on available data and circumstances to meet the
architectural objectives.
3. Difference between Reference Model and Architecture
One analogy is like city planning. The National Enterprise Architecture (NEA) reference model
describes the overall city plan. By referencing it, each government agency will know which part
of the city and what buildings it need to build. The government agency can then develop its own
specific building reference model where it will give more details to the building designs.
From its reference model, the government agency can architecture its current buildings (with more
details like office layout, gardens, parking areas, security offices, masjid and reception office). On
the other hand, the target architecture will show how the buildings will be transform in the future
with the respective details.
Table 8-1 provides the respective descriptions of the various reference models and architectures.
125
National Overall Reference Architecture (NORA) – Handbook
S/No EA Artifact Description
1. NEA Reference Model Saudi government-wide reference model for all
government agencies. It gives the consolidated
government-wide model of the key IT and business
objects and their relationships.
2. Agency Reference Model Specific view of the NEA Reference Model for the
government agency only. It provides the government
agency’s model of its IT and business objects in relation
to the NEA Reference Model.
3. Agency Current Architecture Description and design of the current IT and business
landscape. It shows all the actual current IT, business
objects, and their relationships.
4. Agency Target Architecture Description and design of the target or future IT and
business landscapes. It shows all the future IT and
business objects and their relationships after changes
made to the current architecture (i.e. additions, dele-
tions and modifications of the current IT and business
objects).
Table ‎8-1: Differences between Reference Models and Architectures
8.3 Process to build reference models and architectures
In the next few stages, the government agency will build reference model and architectures in
succession. This section, however, aims to provide a comprehensive view about the building
process and the inter-relationships among these deliverables.
The basic process to develop these deliverables are as follows:
1. Build agency reference models
By referring to the NEA reference models, the government agency has to build its own reference
models. The objective is to analyze from the whole-of-government models, take the appropriate
and relevant context, and build the required architecture elements for the government agency.
126
National Overall Reference Architecture (NORA) – Handbook
2. Build current architectures
From the government agency’s reference models, the EA Core and working teams have to gather
information to reflect the current state of the IT and business landscapes. The outcomes will
describe the government agency’s relevant current architectures. In addition, the government
agency has to analyze and plan for improvements or ways to overcome current challenges and
limitations.
3. Build target architectures
The government agency has to develop target outcomes or goals that will drive the design of
the future target architectures.
Figure 8-1 summarizes the basic process in building these reference models and architectures.
Figure ‎8-1: Basic process in building reference models and architectures
127
National Overall Reference Architecture (NORA) – Handbook
8.4 Building blocks of reference models and architectures
The building blocks or components for NEA reference models, agency reference models
and architectures are similar. Figure 8-2 illustrates the main components in each model or
architecture. The EA Framework developed in the previous stage would also be similar in
terms of the components.
Figure ‎8-2: Building blocks / components
Each model or architecture would minimally describe the following:
1. Purpose & Direction
The purpose statement describes what the model or architecture does. It is specific and normally
measurable. The direction statement describes the main delivery focus; it affects the scope of the
model or architecture.
2. Principles
These are architectural principles for the model or architecture development. Each principle pro-
vides specific scope and reason the development of the model or architecture. As a guideline,
the number of principles should not exceed seven.
128
National Overall Reference Architecture (NORA) – Handbook
3.Artifacts
These are actual deliverables or outcomes of the model or architecture. The artifact name has
to match with the definitions and names in the EA Meta Model. The number of artifacts com-
monly range from 4 to 10 in each model or architecture.
NEA consists of five reference models as shown in the figure below. Each model has the same
building blocks or components. Government agencies have to apply the same building blocks or
components in developing their own reference models and architectures in the next few stages.
Figure ‎8-3: Same building blocks in NEA reference models
129
National Overall Reference Architecture (NORA) – Handbook
8.5 Summary of deliverables for reference models and
architectures
The table below lists the important deliverables or artifacts to be produce in the government
agencies’ reference models and architectures.
Domain
NEA Reference
Model Artifacts
Agency Reference
Model Artifacts
Agency Current Ar-
chitecture Artifacts
Agency Target Ar-
chitecture
Artifacts
Performance Performance Reference
Model
Comprising of:
1.	 Purpose / Direction
2.	 PRM Principles
3.	 Strategic Goals
4.	 Performance Goals
5.	 Measurement Areas
6.	 Measurement Cat-
egories
7.	 Measurement
Groups
8.	 Indicators
Performance Reference
Model
1.	 Comprising of:
2.	 Purpose / Direction
3.	 PRM Principles
4.	 Strategic Goals
5.	 Performance Goals
6.	 Measurement Areas
7.	 Measurement Cat-
egories
8.	 Measurement Groups
9.	 Indicators
N.A. N.A,
The performance
measurement indicators
will be embedded in the
various target architec-
tures
Business Business Reference
Model
Comprising of:
1.	 Purpose / Direction
2.	 BRM Principles
3.	 Business Area
4.	 Line of Business
(LoB)
5.	 Business Function
Business Reference
Model
Comprising of:
1.	 Purpose / Direction
2.	 BRM Principles
3.	 Business Area
4.	 Line of Business (LoB)
5.	 Business Function
6.	 Sub-Business Function
Purpose / Direction
1.	 BA Principles
2.	 Agency BRM
3.	 Organizational Chart
4.	 Business Function
5.	 Business Processes
6.	 Service Catalogue
Purpose / Direction
1.	 BA Principles
2.	 (reviewed / updated)
3.	 Organizational Chart
(reviewed / updated)
4.	 Business Function
(reviewed / updated)
5.	 Business Processes
(improved)
6.	 Service Catalogue
(updated)
130
National Overall Reference Architecture (NORA) – Handbook
Domain
NEA Reference
Model Artifacts
Agency Reference
Model Artifacts
Agency Current Ar-
chitecture Artifacts
Agency Target Ar-
chitecture
Artifacts
Application Application Reference
Model
Comprising of:
1.	 Purpose / Direction
2.	 ARM Principles
3.	 Application Sys-
tems
4.	 Application Com-
ponents
5.	 Application Inter-
faces
6.	 Best Practices and
Guidelines
7.	 Application
Systems for Saudi
Government
8.	 List of National
Shared Application
Systems
Application Reference
Model
Comprising of:
1.	 Purpose / Direction
2.	 ARM Principles
3.	 Application Systems
4.	 Application Compo-
nents
5.	 Application Interfaces
6.	 Prioritized List of Ap-
plication Systems
Purpose / Direction
AA Principles
Agency ARM
Application Overview
Application Catalogue
Application Functions
Application Relationships
Application Consolidation
Plan (optional)
Purpose / Direction
AA Principles
(reviewed / updated)
Application Overview
(updated)
Application Catalogue
(updated)
Application Functions
(updated)
Application Relation-
ships (updated)
List of Agency Shared
Application Systems
and Components
(optional)
Data Data Reference Model
Comprising of:
Purpose / Direction
DRM Principles
National Data Model
Data Classification
Data Structure
Data Exchange
Data Management
List of National Shared
Data Services
Data Reference Model
Comprising of:
Purpose / Direction
DRM Principles
Conceptual Data Model
Data Classification
Data Structure
Data Exchange
Data Management
Purpose / Direction
DA Principles
Agency ARM
Conceptual Data Model
Logical Data Model
Data Flow Diagram
Database Portfolio Cata-
logue
Data dictionary
Data Consolidation Plan
(optional)
Purpose / Direction
DA Principles (re-
viewed / updated)
Conceptual Data Model
(updated)
Data Management
(updated)
Logical Data Model
(updated)
Data Flow Diagram
(updated)
Database Portfolio Cata-
logue (updated)
Data dictionary (up-
dated)
List of Agency Shared
Data Services (optional)
131
National Overall Reference Architecture (NORA) – Handbook
Domain
NEA Reference
Model Artifacts
Agency Reference
Model Artifacts
Agency Current Ar-
chitecture Artifacts
Agency Target Ar-
chitecture
Artifacts
Technology Technology Reference
Model
Comprising of:
Purpose / Direction
TRM Principles
Service Area
Service Category
Service Standards
Technology Reference
Model
Comprising of:
Purpose / Direction
TRM Principles
Service Area
Service Category
Service Standards
Purpose / Direction
TA Principles
Agency TRM
IT Infrastructure Overview
IT Infrastructure Descrip-
tion
Hardware Catalogue
Software Catalogue
Purpose / Direction
TA Principles (re-
viewed / updated)
IT Infrastructure Over-
view (updated)
IT Infrastructure
Description (updated)
Hardware Catalogue
Software Catalogue
List of Agency Shared
Infrastructure Services
(optional)
Table ‎8-2: Summary of artifacts by reference models and architectures
132
National Overall Reference Architecture (NORA) – Handbook
Stage5–Build
ReferenceModels
133
National Overall Reference Architecture (NORA) – Handbook
9. Stage 5 – Build Reference
Models
9.1 Stage summary
The previous section has defined and described the reference models and architectures. Based on
the EA framework developed previously, this stage is all about building the reference models so
that a government agency can have standard views and taxonomies of key organizational assets
and processes such as business, application, data and technology domains.
9.2 Stage purpose
The purpose of stage 5 is to architect and build the relevant EA reference models of the government
agency. The following specific expected outcomes from this stage are:
1.	Performance Reference Model
2.	Business Reference Model
3.	Application Reference Model
4.	Data Reference Model
5.	Technology Reference Model.
Note that the above are recommended outcomes. A government agency can have more or less,
or even combine reference models depending on its EA requirements, its EA framework design
and its EA goals. Other examples of reference models are security reference model, service
reference model and infrastructure reference model.
9.3 Stage initiation
This stage requires the EA vision, mission, architecture goals & principles, and the EA framework
from the previous stage. In addition, the government agency needs to refer to Yesser’s NEA
Reference Models. By referring to the NEA reference models, the government agency can de-
velop their own reference models ensuring alignment with whole of government as well as to
achieve its EA goals.
134
National Overall Reference Architecture (NORA) – Handbook
9.4 About NEA reference models
Since the government agencies have to refer to NEA reference models, it is a pre-requisite to
understand all the five reference models and their inter-relationships.
The objectives or goals of the NEA reference models are:
1.	To provide whole-of-government structured information on IT and business landscapes
2.	To provide effective views or perspectives for different stakeholders in the government –
from business to applications to data to IT infrastructure
3.	To provide a reference point for government agencies to review and distill relevant informa-
tion and design for their own use.
Figure 9-1 illustrates the NEA reference models and their inter-relationships.
Figure ‎9-1: NEA reference models and their inter-relationships
135
National Overall Reference Architecture (NORA) – Handbook
a. Performance Reference Model
The Performance Reference Model (PRM) is an outcome-focused measurement framework
that can assist government agencies in the design and implementation of effective business
measurement systems and performance architectures. The PRM, through the measurement
indicators, sets the performance standards for the government. Hence, from an architectural
viewpoint, the PRM sets the performance standards for the other four reference models.
b. Business Reference Model
The Business Reference Model (BRM) is a classification category used to describe the type of
business functions for the whole of Saudi government. It gives a logical functional view instead
of functions by physical government agencies. The functions and requirements in BRM drives
the other reference models, i.e. Application Reference Model, Data Reference Model and Tech-
nology Reference Model.
c.Application Reference Model
The Application Reference Model (ARM) is a categorization of different types of application
systems, application components and interfaces. It is the framework for categorizing national
shared IT systems and application components to help identify opportunities for sharing, reuse,
and consolidation or renegotiation of software licenses. The ARM supports directly the BRM in
delivering the business outcomes.
d. Data Reference Model
The DRM (Data Reference Model) is a model that classifies data and defines a standard data
structure to support developing data architecture and promoting data standardization/reuse/
management. The DRM supports the ARM directly in delivering business goals by supplying
data and information. The various application systems have to use data to provide information
to the businesses.
e.Technology Reference Model
The Technology Reference Model (TRM) classifies and defines technologies and technology
standards/specifications that support businesses and services. Under structured technology
classifications, technology standards are define to promote inter-operability among govern-
ment agencies. The TRM supports the data usage in DRM, supports application systems in ARM
through the technology definitions and infrastructure implementations, and supports the agen-
cy staff through use of personal and office technologies.
Please refer to the actual NEA reference models for details.
136
National Overall Reference Architecture (NORA) – Handbook
9.5 Key steps in stage 5
Stage 5 is all about building the relevant reference models. Table 9-1 lists all the key steps in Stage 5.
Stage
/ Step
No
Description Deliverable
5 Document Government Agency’s Reference Models Government Agency’s Reference
Models
5.1 Develop a model that standardizes performance
elements for improving IT projects and their
quality. Obtain approval from the EA Governance
Committee
Approved Performance Reference
Model
5.2 Develop a model that classifies and defines busi-
ness functions and related information. Obtain
approval from the EA Governance Committee
Approved Business Reference
Model
5.3 Develop a model that classifies and defines
shared application systems/components to pro-
mote service integration and reuse by identifying
redundant or correlated applications. Obtain ap-
proval from the EA Governance Committee
Approved Application Reference
Model
5.4 Develop a model that classifies data and defines
standard data structures to support data architecture
development, data standard, and data reuse. Obtain
approval from the EA Governance Committee
Approved Data Reference
Model
5.5 Develop a model that classifies and defines
technologies and technology standards/speci-
fications, which support business and services.
Obtain approval from the EA Governance Com-
mittee
Approved Technology Reference
Model
Table ‎9-1: Stage 5 steps
In building the various agency’s reference models, the EA Core and working teams have to make
reference to its EA Framework (developed in Stage 4) and NEA Reference Models.
137
National Overall Reference Architecture (NORA) – Handbook
9.5.1 Step 5.1 Build performance reference model
The Performance Reference Model (PRM) is an outcome-focused measurement framework that
can assist government agencies in the design and implementation of effective business measure-
ment systems and performance architectures.
It is made up of an hierarchical model that helps identify measurement needs; a classification
framework that describes the types of measurement that can support the identified needs; and
a measurement framework that helps define effective measurement indicators.
NEA PRM
Figure 9-2 shows the NEA PRM artifacts while Table 9-2 describes the artifacts or deliverables.
Government agencies have to refer and understand the NEA PRM artifacts and contents. Please
refer to the PRM details and consult NEA office for clarification or discussion.
Figure ‎9-2: NEA PRM artifacts
138
National Overall Reference Architecture (NORA) – Handbook
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of PRM
2 PRM Principles The architectural principles of PRM
3 Strategic Goals / Outcomes The highest level strategic outcomes for Saudi
government
4 Performance Goals The specific performance goals in certain areas and
/ or over certain time period for Saudi government
5 Measurement Areas The various broad areas for measurement
6 Measurement Categories The various categories for measurement within
a measurement area
7 Measurement Groups The various groups for measurement within a
measurement category
8 Indicators The actual measurement indicators
Table ‎9-2: PRM artifact descriptions
Relationship between NEA PRM and Agency PRM
The NEA PRM describes the reference for whole-of-government performance standards. By
referencing the NEA PRM, a government agency can extract the relevant scope that is applicable.
Hence, the agency PRM is like a sub-set of the NEA PRM and the diagrams for both NEA PRM and
agency PRMs are the same. However, the agency PRM has to describe more detail performance
indicators for the government agency within the same measurement categories and groups. At
the same time, the agency PRM has to align with the NEA PRM in terms of the high-level strategic
goals and measurement areas.
Building the Agency PRM
Table 9-3 summarizes the main activities for building the agency PRM.
139
National Overall Reference Architecture (NORA) – Handbook
S/No Activity Artifact / Deliverable
1 Define the PRM purpose or direction PRM purpose / direction statement
2 Define the PRM principles PRM principles
3 Define the Strategic Goals and Perfor-
mance Goals
Strategic goals and performance goals
for agency
4 Define the Measurement Areas, Catego-
ries, Groups and Indicators
Set of indicators within measurement
groups within measurement categories
within measurement areas
5 Document and review the draft PRM Reviewed draft PRM
6 Obtain governance approval Approved agency PRM
Table ‎9-3: Main activities to build agency PRM
1. Define the PRM purpose or direction
Depending on the actual EA scope for the government agency, it has to define the appropriate
PRM purpose or direction. The government agency can refer to the NEA PRM’s purpose or goals
to further refine or localize its purpose. The figure below shows an example of the PRM purpose
and direction.
Figure ‎9-3: Example PRM purpose and direction
140
National Overall Reference Architecture (NORA) – Handbook
2. Define the PRM principles
Refer to NEA PRM principles to adopt and adapt for the government agency’s own PRM principles.
Note that good principles would aid or direct the subsequent development work of the PRM. As a
guide, there should not be more than seven principles.
3. Define the Strategic Goals and Performance Goals
From the NEA PRM’s strategic goals, identify the relevant goals that are directly applicable to
government agency. For each of the strategic goals identified, adapt it into local agency context
that will become the agency’s strategic goals. If need be, refer to the government agency’s strat-
egy / annual plans and royal decrees if any. It would also be effective to illustrate the strategic
goals and performance goals in a diagrammatic form as shown below.
Figure ‎9-4: Example PRM strategic goals / outcomes
141
National Overall Reference Architecture (NORA) – Handbook
4. Define the Measurement Areas, Categories, Groups and Indicators
The next few activities are inter-related. With reference to NEA PRM, analyze and localize the
measurement areas, categories, groups and indicators.
The measurement areas refer to the highest level in the government agency. Typically, these
measurements can derive from Mission, Vision and highest level PKIs. Examples of measure-
ment areas are Customers / Public, Investments, Expenditures, Employees, Technologies and
Assets. For each area, drill down to define the measurement categories such as financial, HR,
customer service and IT. The next step is to define the measurement groups such as division,
branch, department, unit and team.
It is advisable to develop progressively evaluation indicators for a specific group since it is dif-
ficult to do all at once. Table 9-4 shows examples of measurement indicators.
Measure-
ment Area
Measurement
Category
Indicator
S/No
Indicator Defini-
tion
Measurement
Method
Measurement Indi-
cator
Customer Customer
Satisfaction
C.1 Satisfaction
response by
customer
Immediately after
service by pressing
Satisfaction Rating
button
% of satisfaction by
Very Good, Good,
OK, Bad, Very Bad
C.2 Average time
to process cus-
tomer’s inquiry
Survey to random
sampling of
customers
Number of hours
Technol-
ogy
IT Service
Request
T.1 Number of
Processed IT
Request
Calculate number
of processed IT
requests to total
requests received
% of processed IT
request
New Tech-
nologies
T.2 Number of New
Technologies
Adopted
Number over the
year
Number of new
technologies
Table ‎9-4: Example measurement areas, categories and indicators
142
National Overall Reference Architecture (NORA) – Handbook
Figure ‎9-5: Example of PRM indicator description
5. Document and review the draft PRM
After all the definitions, document all the relevant information into a structured information
base on the agency’s documentation standards. Do an internal review and updates. It is also
advisable to get another party to carry out a final review.
6. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to the
EA Governance Committee. The Chief Architect or Business Architect should front this presen-
tation. From the comments from the committee, make the necessary changes to obtain their
final approval.
143
National Overall Reference Architecture (NORA) – Handbook
9.5.2 Step 5.2 Build business reference model
The Business Reference Model (BRM) is a classification category used to describe the type of
business functions at the government agency, in a given sector or national levels. BRM focuses
on categorizing a business base on structured business elements such as business area, line of
business and business functions perform by the government agency.
NEA BRM
Figure 9-6 shows the NEA BRM artifacts while Table 9-5 describes the artifacts or deliverables.
Government agencies have to refer and understand the NEA BRM artifacts and contents. Please
refer to the BRM details and consult NEA office for clarification or discussion.
Figure ‎9-6: NEA BRM artifacts
144
National Overall Reference Architecture (NORA) – Handbook
S/No
Artifact /
Deliverable
Description
1 Purpose / Direction The purpose of BRM
2 BRM Principles The architectural principles of BRM
3 Business Areas The highest abstract groupings of business for Saudi government
4 Lines of Business The broad logical groupings of business for Saudi government
(instead of definitions by physical agencies)
5 Business Functions The main business functions within each Line of Business
6 Sub-Business Functions The finer-grain business functions within each business function
Table ‎9-5: BRM artifact descriptions
Definitions
The following are the main definitions for common understanding:
Business Area
A Business Area is the collection of the highest abstraction description of related government’s
accountabilities to the different stakeholders such as the Royal Family, citizens, businesses and
internal governments.
Line of Business (LoB)
An LoB is a broad collection of government roles and responsibilities (both primary and sec-
ondary) within a Business Area. The LoB’s perspective is from a role or responsibility, and not
by government agency.
Business Function
A Business Function is a set of work to be carry out to accomplish the roles and responsibilities
described in the LoB. Each LoB has two or more business functions.
145
National Overall Reference Architecture (NORA) – Handbook
Sub-Business Function
A Sub-Business Function is a set of physical activities to be carry out to complete the work
defined in the business function. A Business Function has two or more sub-business functions.
Relationship between NEA BRM and Agency BRM
The NEA BRM describes the reference for whole-of-government business. By referencing the NEA
BRM, a government agency can understand how it relates to the different line of business (LoB)
under different business areas. By extracting the relevant business scope that is applicable, the
agency can develop its own BRM. Hence, the agency BRM is like a sub-set of the NEA BRM (the
diagram for agency and NEA BRMs are the same). However, the agency BRM has to describe more
detail business functions and sub-business functions for the government agency within each LoBs.
Through such definitions, the agency BRM will align with the NEA BRM in terms of the high-level
business areas and line of business.
Building the Agency BRM
Below table summarizes the main activities for building the agency PRM.
S/No Activity Artifact / Deliverable
1 Define the BRM purpose or direction BRM purpose / direction statement
2 Define the BRM principles BRM principles
3 Define the Business Areas, Lines of Busi-
ness (LoB), Business Functions and Sub-
Business Functions
List of related business areas, LoBs,
business function and sub-business
function descriptions
4 Document and review the draft BRM Reviewed draft BRM
5 Obtain governance approval Approved agency BRM
Table ‎9-6: Main activities to build agency BRM
146
National Overall Reference Architecture (NORA) – Handbook
1. Define the BRM purpose or direction
Depending on the actual EA scope for the agency, define the BRM purpose or direction. In addition
to improving overall effectiveness, the agency BRM typically gives an insight into the actual
accountabilities, roles, key functions and relationships with other government agencies. The
BRM is also an excellent tool to aid e-Government transformation. It is also necessary to refer
to the agency PRM and incorporate relevant strategic goals and measurements into the BRM.
The figure below gives an example purpose or direction for BRM.
Figure ‎9-7: Example BRM purpose
2. Define the BRM principles
Refer to NEA BRM principles to adopt and adapt for the government agency’s own BRM principles.
Note that good principles would aid or direct the subsequent development work of the BRM. As a
guide, there should not be more than seven principles.
3. Define the Business Areas, Lines of Business (LoB), Business Functions
and Sub-Business Functions
This step has a few inter-related activities that is best done collectively in an hierarchical way.
Refer to NEA BRM and do the following:
a. Find the related business areas that the agency has accountabilities or responsibilities
b. Similarly, for each business area identified, find the LoBs for the agency. Please note that the
BRM is a logical representation of responsibilities. Thus, it is common that an agency is involve
in at least two LoBs
c. For each LoB, find all the related business functions
d. Finally, for each business function, find all the sub-business functions carry out by the agency.
147
National Overall Reference Architecture (NORA) – Handbook
Figure ‎9-8: Example of business area, LoB, business function and sub-business functions
The figure above illustrates the relationship and information on the various business artifacts
or descriptions for Ministry of Education (MoE). This is only an example and does not fully
depict the actual case for MoE. For the same example, the information can also be shown in
the table below.
148
National Overall Reference Architecture (NORA) – Handbook
Business
Area
Line of
Business
Business Function
Sub-Business
Function
Royal Family
Affairs
Not listed Not listed Not listed
Citizen Services Education Pre-School to High-School
Education
1.	 Curriculum Planning for
Schools
2.	 School Administration
and Governance
Graduate and Post-Graduate
Education
1.	 Curriculum planning for
universities
2.	 Accreditation
Business Services Licensing &
Regulatory Control
Licensing & Regulatory Con-
trol of Private Schools
1.	 Registration and Com-
munication with Private
Kindergartens & Schools
2.	 Licensing Management
3.	 Regulatory Enforcement
Government
Services
Not listed Not listed Not listed
Table ‎9-7: Example of business area, LoB, business function and sub-business functions
1. Document and review draft BRM
After listing all the definitions, document the relevant information into a structured information
base on the agency’s documentation standards. Do an internal review and updates. It is also
advisable to get another party to carry out a final review.
2. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to
the EA Governance Committee. The Chief Architect or Business Architect should front this
presentation. From the comments from the committee, make the necessary changes to ob-
tain their final approval.
149
National Overall Reference Architecture (NORA) – Handbook
9.5.3 Step 5.3 Build application reference model
The Application Reference Model (ARM) is a categorization of different types of application
systems, application components and interfaces. It is the framework for categorizing national
shared IT systems and application components to help identify opportunities for sharing, reuse,
.and consolidation or renegotiation of SW licenses
NEA ARM
Figure 9-9 shows the NEA ARM artifacts while Table 9-8 describes the artifacts or deliverables.
.Government agencies have to refer and understand the NEA ARM artifacts and contents
Figure ‎9-9: NEA ARM artifacts
150
National Overall Reference Architecture (NORA) – Handbook
S/
No
Artifact /
Deliverable
Description
1 Purpose / Direction The purpose of ARM
2 ARM Principles The architectural principles of ARM
3 Application Systems The application systems to support business. It can be classified as
a core application system or a supporting application system
4 Application Components The key application component classifications and descriptions
5 Application Interfaces The common methods or interfaces to connect among applications
6 Best Practices & Guidelines The common best practices and guidelines for development and
implementation of application systems, components and interfaces
7 Application Systems for
Saudi Government
The guide for choosing and prioritizing applications systems for
government agencies
Table ‎9-8: ARM artifact descriptions
The figure below illustrates the structured diagram of NEA ARM. It shows the classifications of
the supporting application systems, application components and interfaces. Please refer to the
ARM details and consult NEA office for clarification or discussion.
151
National Overall Reference Architecture (NORA) – Handbook
Figure ‎9-10: Structured diagram of application systems, components and interfaces in NEA ARM
Relationship between NEA ARM and Agency ARM
The NEA ARM describes the reference for whole-of-government application systems development.
By referencing the NEA ARM, a government agency can understand the structure and
classifications applications systems, components and interfaces. The NEA ARM also describes
the common application systems for use in government supporting business functions. There
is also a best practices and guidelines on application development and maintenance so that
government agencies can develop quality application systems. Finally, the NEA ARM guides
government agencies in choosing and prioritizing their application development.
152
National Overall Reference Architecture (NORA) – Handbook
The agency ARM, on the other hand, describes the main application systems (core and supporting),
components and interfaces for development and implementation specifically for the agency.
These application systems have to support the businesses as defined in the agency BRM. In
addition, the agency BRM would have a prioritized list of application systems for development.
The agency ARM structure is shown in the figure below. The agency ARM has to ensure alignment
with the NEA ARM in terms of the high-level application system and component classifications.
Figure ‎9-11: Agency ARM artifacts
153
National Overall Reference Architecture (NORA) – Handbook
Building the Agency ARM
Below table summarizes the main activities for building the agency ARM.
S/No Activity Artifact / Deliverable
1 Define the ARM purpose or direction ARM purpose / direction statement
2 Define the ARM principles ARM principles
3 Define the application systems List of core and supporting application system
descriptions for the agency
4 Define the application components List of key application component descriptions
5 Define the application interfaces List of key application interface descriptions
6 Prioritize the application systems List of prioritized application systems for devel-
opment
7 Document and review Reviewed draft ARM
8 Obtain governance approval Approved agency ARM
Table ‎9-9: Main activities to build agency ARM
1. Define the ARM purpose or direction
Depending on the EA scope of the agency, the EA Core and working teams have to discuss and
agree on the ARM purpose or direction. It is also necessary to refer to the agency PRM and in-
corporate relevant strategic goals and measurements into the ARM. Below is an example of an
ARM purpose or direction statement.
Figure ‎9-12: Example ARM purpose or direction
154
National Overall Reference Architecture (NORA) – Handbook
2. Define the ARM principles
Refer to the NEA ARM principles as shown below. A good set of principles will aid the development
of the agency ARM. Review and customize the appropriate principles for the agency ARM. As a guide,
do not have more than seven principles.
S/
No
Principle Description
1 Strategic Driven Applications Design and prioritize application systems that deliver
strategic outcomes.
2 Cross-Agency Application Systems Design and develop application systems that serve
multiple government agencies.
3 Easy-to-Use yet Secured Application
Systems
Design and develop application systems that are easy-
to-use and, at the same time, highly secured.
4 Adaptable and Reusable Application
Systems & Components
Design and develop application systems using reusable
components and systems while being adaptable to the
constant changes.
5 Vendor-Neutral Application Systems Design and develop vendor-neutral application systems.
Table ‎9-10: NEA ARM principles
3. Define the application systems
The agency has to define the application systems into core and supporting. As application
systems are required to support the business, the EA Core and working teams must refer to the
agency BRM. Each business function should be supported by at least one application system.
The team should then review the sub-business function and rationalize if the same application
system can be support that sub-business function; if not, then another specific application
system may be required for the sub-business function.
155
National Overall Reference Architecture (NORA) – Handbook
Figure ‎9-13: Example of MOE’s business and sub-business functions
In the example above, under Education LoB, MOE requires at least two applications to support
the ‘Pre-School to High School Education’ and the ‘Graduate and Post-Graduate Education’.
However, it is not practical to have one system to support the two sub-business functions – i.e.
‘Curriculum Planning for Schools’ and ‘School Administration & Governance’ as they are rather
varied functional requirements. Thus, MOE requires at least two application systems under the
Pre-School to High School Education. Similarly, MOE requires another two application systems to
support the two sub-business processes under ‘Graduate and Post-Graduate Education’.
In the same token, MOE will have a list of application systems to support the common business
functions or sub-business functions such as finance management, IT management, corporate
planning & development, and building management among others.
The EA Core and working teams must also identify the potential application system owner. If
the government agency is the primary owner of the business or sub-business function, then the
agency has to develop the identified core application. However, if the agency plays a secondary
or supporting function to the business function, then the agency should use the application
system developed by the primary agency.
Thus, by now, the government agency should have a clear list of what application systems it
has to own and develop, and what are the applications it should use from the other primary
government agencies.
156
National Overall Reference Architecture (NORA) – Handbook
4. Define the application components
NEA ARM has defined the main application component classifications. Please review them all.
In most cases, the agency should adopt all these application components as they are generic
yet useful. In addition, review and add other application components to aid the development of
the agency’s applications. Al these application components should and can be re-use or shared.
5. Define the application interfaces
Like the pervious step, review the list of the common shared application interfaces developed
by Yesser. The government agency should be able to adopt most of the application interfaces.
Similarly, review and add other specific application interfaces required.
6. Prioritize the application systems
Refer to the NEA ARM ‘Application Systems for Saudi Government’ section. Follow the steps to
help the government agency prioritize its application systems. At the end of this process, the
government agency would have different lists with different priorities for application system
development.
7. Document and review
After listing all the prioritized application systems, components and interfaces, document the rel-
evant information into a structured information base on the agency’s documentation standards. It
is recommended to map out the relationship between the application systems and the business or
sub-business functions. Do an internal review and updates. It is also advisable to get another party
such as business / application owners to carry out a final review.
8. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to the
EA Governance Committee. The Chief Architect or Application Architect should front this
presentation. From the comments from the committee, make the necessary changes to obtain
their final approval.
157
National Overall Reference Architecture (NORA) – Handbook
9.5.4 Step 5.4 Build data reference model
The Data Reference Model (DRM) is a model that classifies data and defines a standard data
structure to support developing data architecture and promoting data standardization / re-
use / management. The DRM gives a standard data classification for all the data use in the
government agency, including the data sources and the data relationships.
NEA DRM
Figure 9-14 shows the NEA DRM artifacts while Table 9-11 describes the artifacts or deliver-
ables. Government agencies have to refer and understand the NEA DRM artifacts and contents.
Figure ‎9-14: NEA DRM artifacts
158
National Overall Reference Architecture (NORA) – Handbook
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of DRM
2 DRM Principles The architectural principles of DRM
3 National Data Model The data model for KSA government
4 Data Classification The major data classifications
5 Data Structure The overall data structure
6 Data Exchange The common methods for data exchange
7 Data Management The guide for data management for agencies
Table ‎9-11: DRM artifact descriptions
The figure below illustrates the overall NEA DRM. It provides descriptions of the various arti-
facts. Please refer to the DRM details and consult NEA office for clarification or discussion.
Figure ‎9-15: NEA DRM
159
National Overall Reference Architecture (NORA) – Handbook
Relationship between NEA DRM and Agency DRM
The NEA DRM provides the reference for whole-of-government data usage and standardization.
By referencing the NEA DRM, a government agency can understand the high-level data model,
data classification, data structure and data exchange. The NEA DRM also provides the data man-
agement guide for quality and reliable data usage and exchange.
On the other hand, the agency DRM describes the main data model for its own use based on
the NEA DRM artifacts. The agency DRM will have its own agency data model, data classification,
data structure and data exchange.  The agency DRM structure is shown in the figure below. The
agency DRM has to ensure alignment with the NEA DRM in terms of the data model, data clas-
sification, data structure and data exchange.
Figure ‎9-16: Agency DRM artifacts
160
National Overall Reference Architecture (NORA) – Handbook
Building the Agency DRM
Below table summarizes the main activities for building the agency DRM.
S/No Activity Artifact / Deliverable
1 Define the DRM purpose or direction DRM purpose / direction statement
2 Define the DRM principles DRM principles
3 Define the data model Data model for agency
4 Define the data classifications Key data classifications for agency
5 Define the data structure Main data structure for agency
6 Define the data exchanges Data exchanges for agency
7 Document and review Reviewed draft DRM
8 Obtain governance approval Approved agency DRM
Table ‎9-12: Main activities to build agency DRM
1. Define the DRM purpose or direction
Depending on the EA scope of the agency, the EA Core and working teams have to discuss and
agree on the DRM purpose or direction. It is important to scope carefully the DRM, as it can
potentially be very wide. It is also necessary to refer to the agency PRM and incorporate relevant
strategic goals and measurements into the DRM. Below is an example of a DRM purpose or
direction statement.
161
National Overall Reference Architecture (NORA) – Handbook
Figure ‎9-17: Example for defining DRM purpose
2. Define the DRM principles
Refer to the NEA DRM principles. A good set of principles will aid the development of the agency
DRM. Review the NEA DRM principles and customize the appropriate principles for the agency
DRM. As a guide, do not have more than seven principles.
3. Define the data model
The objective of a data model is to show data in a logical and structured method that aid data
discovery and data re-use. It provides the overall view of all the different architectural data
components in a structured fashion.
By referring to the NEA DRM, each government agency can identify which data are established
and operational at the national level. Similarly, the agency has to build its data model to depict
operational data used in the agency. Develop a similar data model for the government agency.
The data model would have data classifications, data structure and data exchanges.
162
National Overall Reference Architecture (NORA) – Handbook
4. Define the data classifications
The amount of data can easily cause operational complexities in any government agency. With
massive data elements from different sources, it is necessary to organize and classify data so
that the agency can efficiently search, use and manage data.
Refer to NEA DRM. Based on the data required by the government agency, classify these data
accordingly. The figure below is an example data classification.
Figure ‎9-18: Example for developing data classification structure
5. Define the data structure
The NEA DRM has defined data structure consisting of data elements, data entities, data properties
and their relationships. Similarly, define the data structure for the agency data. The EA Core or
working teams may want to start be defining the structure for commonly use data in the agency.
Below is an example of data structure definitions. Note that a number of these data definitions
map to the data classifications established in the above step. In addition, the agency has to docu-
ment the data properties and relationships.
163
National Overall Reference Architecture (NORA) – Handbook
Items of Entity
Definition
Entity Description
Entity Name
As entity name to be managed by agency DRM, it is uniquely, consistently
named by using business terms
Entity Definition Defines both what is the entity and to whom, how, where the entity is used
Data Subject Area
Data subject area which the relevant entity belongs to in data classification
system
Data Group
Data group which the relevant entity belongs to in data classification sys-
tem
Unusual Remark of Entity Describing items to separately emphasize, except entity definition
Entity Version Relevant entity’s version
Entity Ownership Name or code of an agency or department creating the relevant entity
Table ‎9-13: Example data structure definition
6. Define the data exchanges
Finally, define the data exchanges with other government agencies. Based on the data entities
defined above, simply list all the data exchanges. For alignment, please refer to the NEA DRM
for the data exchange definitions and methods. The table below is an example list of data ex-
change.
S/
No
Data
Entity
Agency Name
/ Location
Exchange
Description
Exchange
Frequency
Exchange
Direction
1 Name of
data entity
Name of agency
and location or
branch
Description about
the data exchange
and data entity
Frequency
such as
monthly,
weekly, daily,
hourly
Inbound or
Outbound
Table ‎9-14: Example data exchange definition
164
National Overall Reference Architecture (NORA) – Handbook
7. Document and review
Upon completion of the above deliverables, the EA Core and working teams have to document
the DRM according to the agency’s documentation standard. Carry out an internal review. In
addition, it is recommended to get other parties to review the DRM such as the business team
and the DBAs.
8. Obtain governance approval
With the completion of the deliverables with the other above related contents, present it to
the EA Governance Committee. The Chief Architect or Data Architect should front this pre-
sentation. From the comments from the committee, make the necessary changes to obtain
their final approval.
9.5.5 Step 5.5 Build technology reference model
The Technology Reference Model (TRM) classifies and defines technologies and technology
standards/specifications that support businesses and services. The purpose of TRM is for enu-
merating and understanding the underlying IT service & technology elements, analyzing them
and then applying classifications and relevant standards.
NEA TRM
Figure 9-19 shows the NEA TRM artifacts while Table 9-15 describes the artifacts and deliver-
ables. Government agencies have to refer and understand the NEA TRM artifacts and contents.
Please refer to the TRM details and consult NEA office for clarification or discussion.
165
National Overall Reference Architecture (NORA) – Handbook
Figure ‎9-19: NEA TRM artifacts
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of TRM
2 TRM Principles The architectural principles of TRM
3 Service Area The highest level technology service area
4 Service Category The technology service category within a service
area
5 Service Standard The list of technology service standards
Table ‎9-15: TRM artifact descriptions
166
National Overall Reference Architecture (NORA) – Handbook
The table below describes the various service areas and service categories.
Service Area Service Categories
Service Access and Delivery Access Channels
Delivery Channels
Service Requirements
Service Transport
Service Platform and Infrastructure Support Platforms
Delivery Servers
Software Engineering
Databases/Storage
Hardware/Infrastructure
Component Framework Security
Presentation/Interface
Programming
Data Interchange
Data Management
Service Interface and Integration Integration
Interoperability
Interface
Table ‎9-16: TRM service area and category descriptions
167
National Overall Reference Architecture (NORA) – Handbook
Relationship between NEA TRM and Agency TRM
The NEA TRM describes the reference for whole-of-government technology standards. By
referencing the NEA TRM, a government agency can extract the relevant scope that is applicable
within the agency. The agency TRM has to describe more detail technology standards where
applicable if these are not describe in the NEA TRM. At the same time, the agency TRM has
to ensure alignment with the NEA TRM in terms of the high-level service areas and service
categories.
Building the Agency TRM
Below table summarizes the main activities for building the agency TRM.
S/No Activity Artifact / Deliverable
1 Define the TRM purpose or direction TRM purpose / direction statement
2 Define the TRM principles TRM principles
3 Define the service areas and service
categories
Service categories within service areas
for the agency
4 Set the service standards Service standards(standard profile) within
each service category relevant for agency
5 Document and review Reviewed draft TRM
6 Obtain governance approval Approved agency TRM
Table ‎9-17: Main activities to build agency TRM
1. Define the TRM purpose or direction
Depending on the actual EA scope for the government agency, it has to define the appropri-
ate TRM purpose or direction. The government agency can refer to the NEA TRM’s purpose or
goals to further refine or localize its purpose. It is also necessary to refer to the agency PRM and
incorporate relevant strategic goals and measurements into the TRM. Figure 9-16 below shows
an example of the TRM purpose and direction.
168
National Overall Reference Architecture (NORA) – Handbook
Figure ‎9-20: Example TRM purpose
Figure ‎9-21: Example TRM structure
169
National Overall Reference Architecture (NORA) – Handbook
2. Define the TRM principles
Refer to NEA TRM principles to adopt and adapt for the government agency’s own TRM prin-
ciples. Note that good principles would aid or direct the subsequent development work of the
TRM. As a guide, there should not be more than seven principles.
3. Define the service areas and service categories
With reference to NEA TRM (see Table 9-17 above), analyze and localize the service areas and
service categories.
In most cases, the agency would adopt all the service areas, as these are high-level technology
classifications. However, the agency may add or remove if required (this is possible if the gov-
ernment agency’s scope for TRM or EA is limited).
For each service area, analyze if the government agency requires the service categories. Simi-
larly, the agency may add or remove service categories if required.
As the service areas and inter-connected with the service categories, it is recommended to do
a thorough review for applicability.
4. Set the service standards
Setting the service standards require research and thorough analysis. The government agency
can refer to NEA TRM’s service standards and adapt them for the agency.
To set the service standards, the following activities are highly recommended:
a. Define ‘standard’ method to define service standards
Firstly, it is necessary to define carefully the standard method to set the service standards.
The agency TRM’s principles may affect the service standards adoption and description. For
example, if one of the TRM principles is not to use vendor-specific technology, then the service
170
National Overall Reference Architecture (NORA) – Handbook
standard cannot describe the vendor products or technology standards. On the other hand,
if there is no such principle on vendor products, the service standards can refer to both open
standards and vendor-specific products.
It is also necessary to define the standard classification such as:
i. Mandatory – standards that shall be complied
ii. Recommended – standards that are good to comply but not a must
iii. New – latest technology standards that can be used if possible
iv. Obsolete – standards that are outdated and should be replaced.
Another consideration is to describe the status and publish date of the standards so that read-
ers know if these are new, revised or outdated standards.
The EA Core team should also ensure that these standard classifications are align with the com-
pliance management under Continuous Governance section.
It is also a ‘standard’ practice is to reference the service standards to the official organization or
vendor source such as ISO, IEEE and OASIS among others.
b. For each service category, collect and list all the necessary technology standards
With all the technology standards, ensure that they are applicable. For related, duplicated or
similar standards, the agency has to decide if would be simpler and more effective to combine
the standards or separate them.
After consolidating all the standards, assign the standard classification and official source of the
standard.
171
National Overall Reference Architecture (NORA) – Handbook
c. Write the actual service standards according to ‘standard’ method
Finally, write the actual service standards in the format or method what was agreed. The EA
Core or working team members have to consider the ability for the reader to quickly search and
find the required service standards.
For examples of good standards, please refer to ISO, IEC, IEEE and OASIS.
5. Document and review
After drafting all the definitions and standards, document all the relevant information into a
structured information base on the agency’s documentation standards. Do an internal review
and updates. It is also advisable to get another party to carry out a final review.
6. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to the
EA Governance Committee. The Chief Architect or Technology Architect should front this pre-
sentation. From the comments from the committee, make the necessary changes to obtain
their final approval.
172
National Overall Reference Architecture (NORA) – Handbook
Stage6–BuildCurrent
Architecture
173
National Overall Reference Architecture (NORA) – Handbook
10. Stage 6 – Build Current
Architecture
10.1 Stage summary
Once the framework and reference models are established and agreed upon, the government
agency embarks on one of the most critical steps in its EA journey. The focus of this stage is
in capturing the current architectures of the government agency so that the agency can clearly
understand its IT and business landscapes. This would allow a better visibility of the interconnections
among different architectures and components, and aid in analyzing the agency’s issues,
challenges and opportunities relating to business, information/data and technologies.
The information captured and architectures created in this stage include Business Architecture,
Application Architecture, Data Architecture and Technology Architecture. The government
agency may build all the current architectures or selective relevant architectures depending on
its EA scope and development strategy.
10.2 Stage purpose
The purpose of this stage is to analyze and document the status of the current government
agency’s IT and business landscapes. The expected outcomes or deliverables of this stage are:
1.	Current Business Architecture
2.	Current Application Architecture
3.	Current Data Architecture
4.	Current Technology Architecture.
Note that the above are recommended outcomes. A government agency can have more or less
architectures depending on its EA scope, goals, EA framework design and development strat-
egy. Other examples not listed above include current security and performance architectures.
174
National Overall Reference Architecture (NORA) – Handbook
10.3 Stage initiation
With the completion of the previous phases, the EA Core Team and working teams have to ensure
that the following deliverables are in place:
1.	Performance Reference Model
2.	Business Reference Model
3.	Application Reference Model
4.	Data Reference Model
5.	Technology Reference Model.
Again, depending on the EA scope and development strategy, the government agency has to
ensure that the corresponding reference models are completed. If the government agency
intends to build all architectures, then it needs the five above reference models. However, if
the government agency is doing a specific EA scope such as data and technology consolidation,
then it needs to have at least the data and technology reference models in place.
175
National Overall Reference Architecture (NORA) – Handbook
10.4 Key steps in stage 6
Table 9-2 list the key activities and expected deliverables for stage 6.
Stage /
Step No
Description Deliverable
6 Build Government Agency’s Current Ar-
chitectures
Government Agency’s Relevant
Current Architectures
6.1 Capture current business and IT data Government Agency’s Current Data
6.2 Analyze and build the business architec-
ture that describes the current business
functions, sub-business functions, busi-
ness processes, business activities and
business services
Government Agency’s Current
Business Architecture
6.3 Analyze and build the application archi-
tecture that lists all the current appli-
cations (fully automated, partial auto-
mated & manual), and the relationships
between these applications and the
business functions / processes / services
Government Agency’s Current
Application Architecture
6.4 Analyze and build the data architecture
that shows all the current data used by
the government agency, the usage of
data by applications including data ex-
change within and externally
Government Agency’s Current
Data Architecture
6.5 Analyze and build the technology archi-
tecture that illustrates the current IT in-
frastructure used by the various applica-
tions, data and people
Government Agency’s Current
Technology Architecture
6.6 Current Architecture Analysis Summary of Improvement Op-
portunities
Table ‎10-1: Stage 6 steps
176
National Overall Reference Architecture (NORA) – Handbook
10.4.1 Step 6.1 Capture current business and IT data
The first important step is to capture both the current business and IT data in the government
agency. Current data is required to understand the actual reality of the agency’s business and
IT landscapes. Data has to be up-to-date, accurate and verified. It is always better to have more
detailed data than insufficient data.
Depending on the agency’s actual EA scope and objectives, the EA Core and working teams have
to prepare the relevant means to capture the required data. If the agency is doing the entire
EA, then it has to capture information about the business, applications, data / databases and
infrastructure. On the other hand, if the agency is doing only technology architecture, then it
has to capture the current IT technologies and infrastructure data.
However, the teams may face difficulty to obtain the support of the various parties or divisions
to capture the current data. As part of change management (please see Continuous Gover-
nance – Change Management section), it is recommended to provide clear communications to
the relevant departments, divisions or branches in the agency on the need for EA and the data
capturing exercise.
The following are the recommended activities to capture current data in the agency:
S/No Activity
1 Identify data elements and data sources required
2 Design data capturing method(s)
3 Design data capturing templates
4 Present to EA Governance Committee on data capturing approach
5 Brief the relevant parties
6 Capture the relevant current data
7 Verify and update
Figure ‎10-1: Data capturing activities
177
National Overall Reference Architecture (NORA) – Handbook
1. Identify data elements and data sources required
The first activity is to identify all the data elements and their respective data sources. The EA
Core and working teams can first refer to their reference models to determine the minimum
reference to artifacts. From these artifacts, identify the main data elements from current data-
bases and application systems. The teams need also to identify data from physical sources such
as forms, catalogues, websites, etc.
The table below provides example sources of capturing data.
Current
Architecture
Possible Data Sources
Business
Architecture
1.	Organization chart
2.	Agency roles and functional descriptions
3.	List of business processes
4.	Service catalogue (if any)
Application
Architecture
1.	Application systems catalogue (if any); else list of all application sys-
tems including application owners and application systems status
2.	List of application functions
Data Architecture 1.	Database management system (DBMS) for all the databases
2.	Database or data schema diagrams
3.	List of data exchanges (external and internal)
4.	Data model (if any)
5.	Database catalogue (if any)
6.	Data flow diagrams (if any)
7.	Data dictionary (if any)
Technology
Architecture
1.	Hardware catalogue
2.	Software catalogue
3.	Software license agreements
4.	Network architecture diagrams
5.	Data center layout diagrams
6.	Storage information (including back-ups)
Table ‎10-2: Example of possible data sources
178
National Overall Reference Architecture (NORA) – Handbook
2. Design data capturing method(s)
Having identified the data elements and the data sources, the next activity is to analyze to de-
termine what data is unavailable. Most of the data should be available in the current systems
somewhere in the government agency. It is important to design a method(s) to capture all these
data into one repository so that the data can be analyzed later in this and subsequent stages.
For data unavailable or not updated, the teams may design data capturing methods such as
questionnaire, data spreadsheet and even online data input screens.
3. Design data capturing templates
The EA Core and working teams have to design the main templates to capture the data. Al-
though different architectures require different data, the teams may consider doing an inte-
grated data capturing exercise so that every data element is captured once. This is an excellent
exercise for the teams to start thinking through the data required for the various architectures.
The data capturing templates can be on spreadsheet or online screen.
4. Present to EA Governance Committee on data capturing approach
This is one of the crucial stages in the EA journey. It is necessary and important to capture all the
right amount data about the government agency. Present the data capturing approach to the
EA Governance Committee so that they understand the importance. In addition, the EA Gover-
nance Committee can provide appropriate directions and ensure relevant parties or divisions in
the agency will support the data capturing exercise.
5. Brief relevant parties
As part of change management, inform the relevant parties or divisions about the EA and in par-
ticular about the data capturing exercise. This briefing aims to get the support of the relevant
parties or divisions. The briefing is a good opportunity to help the spread the message about
the EA benefits.
179
National Overall Reference Architecture (NORA) – Handbook
6. Capture the relevant current data
Request for specific persons to be involved in the data capturing exercise. Brief them the details
of data capturing. Provide all the relevant data capturing templates and guidance to the relevant
parties or divisions. The EA Core and working teams, where required, should closely help those
who are capturing the current data.
7.Verify and update
Verify all the data captured. The EA Core and working teams may need time to verify and update
these data if required. It is recommended that data source owners review these data captured.
The data captured will be used in the next steps.
10.4.2 Step 6.2 Analyze and build current business architecture
In the previous stage, the team has built or document the agency’s Business Reference Model
(BRM) based on the NEA Business Reference Model. The government agency’s BRM will be use
as the main document to build the current Business Architecture (BA).
The current BA reflects the actual business accountabilities, roles, functions, processes and ser-
vices of the government agency. The current BA is useful to understand the various inter-agen-
cy relationships and the detailed internal business complexity affecting the agency’s divisions,
branches and departments.
Relationship between Agency BA and Agency BRM
In the previous stage, the team has developed the agency BRM based on NEA TRM. Thus, now
is the time to reference the agency BRM to build the BA.
In essence, the BA is derive from the agency BRM. The main difference, however, is the mani-
festation of the various artifacts or deliverables to reflect accurately the current state in the
government agency. In short, the BA has more details to depict the actual business scenarios
of the government agency.
The figure below shows the difference between the BRM and BA. As more data and details are
required, there will also be additional artifacts as highlighted in red.
180
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-2: Difference between BRM and BA
Relationships among Agency BA and other architectures
Table 10-13 summarizes the agency BA relationships with other current architectures.
Other Current
Architectures
BA Relationship
AA BA drives the requirements for IT applications  to improve agency per-
formance, productivity and customer service
DA BA requires data and information for decision making and efficient op-
erations
TA BA provides the requirements for organization efficiency and
effectiveness through technologies such as office automation
and personal digital devices.
Table ‎10-3: BA relationship with other architectures
181
National Overall Reference Architecture (NORA) – Handbook
The figure below shows the relationships among BA artifacts and the relationships with artifacts
from other architectures.
Figure ‎10-3: BA artifacts’ relationship diagram
Description about the Agency BA
On completion, the current BA will depict the current business landscape of the government
agency. Since the BA is an expansion of the agency BRM, the following are the artifacts or de-
liverables. Note that there are three additional artifacts or deliverables. Collectively, they will
provide a comprehensive description of the current BA.
182
National Overall Reference Architecture (NORA) – Handbook
S/
No
Artifact / Deliverable Description
1 Purpose / Direction The purpose of BA
2 BA Principles The architectural principles of BA
3 Business Areas(BRM) The main business areas for the agency
4 Lines of Business (BRM) The main LoBs(Line of Business) for the agency
within the business areas
5 Business Functions (BRM) The key business function descriptions within LoBs
6 Sub-Business Functions (BRM) The sub-business function descriptions within
each business function
7 Business Processes The list of business process descriptions within
each sub-business function
8 Organization Chart The current organization chart for the agency
9 Service Catalogue The current list of business services
Table ‎10-4: BA artifact descriptions
Building the Agency BA
Below table summarizes the main activities for building the agency BA.
S/
No
Activity Artifact / Deliverable
1 Define the BA purpose or direction BA purpose / direction statement
2 Define the BA principles BA principles
3 Document the organization information Organization chart
4 Define the business functions(BRM) Reviewed / updated business areas, LoBs,
business functions and created sub-busi-
ness functions
5 Define the business processes List  of business processes for the agency
6 Document the service catalogue Service catalogue
7 Document and review Reviewed draft current BA
8 Obtain governance approval Approved agency current BA
Table ‎10-5: Activities to build BA
183
National Overall Reference Architecture (NORA) – Handbook
1. Define the BA purpose or direction
The TA and TRM purposes are alike. The difference is that the TA purpose can show actual out-
comes directly. Review the TRM purpose, amend and define the TA purpose or direction.
2. Define BA principles
The BA and BRM principles are similar. The slight difference is that the BA has to describe more
organizational and services information. Hence, it is necessary to review the BRM principles and
may make minor changes or additions in particular about addressing more service-orientation
for the government agency.
3. Document the organization information
This step is simply to document the main organizational information about the government
agency. This helps in ensuring alignment with government agency’s primary purpose and ac-
countability.
The main information to be captured are the organization chart, and its mission and vision
statements. Other information such as broad strategies and goals of the government agency
are optional items.
Note that if the information are already available in the BRM, then the EA Core team has to
simply verify and update them. If it is not available, then the information have to be officially
sourced and documented. Typically, the organizational information should be available on of-
ficial websites. Figure 10-3 is an example of an organization chart, while Table 10-5 lists the
main attributes of an organization.
184
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-4: Organizational chart example
185
National Overall Reference Architecture (NORA) – Handbook
Property Description
Relationship
with national
meta model
Name
An organizational unit is any functional unit like Corporate/department/
section that collectively executes the business functions.
It is also use to represent any external entities such as Government Agencies,
Ministries, Authorities and Councils.
It could also represent a collaboration of multiple Organization Units (like
committees and programs)
-
Description The government agency’s main mission, vision or role -
Type The government type such as ministry, authority, council, center, program, etc. -
Hierarchy Level The different organizational levels in the government agency -
Child Units
A group or unit of staff reporting to a higher level supervisory unit or
department
-
Location The actual location such as city or town names -
Has Positions The number of positions in the same hierarchy -
Owned Business
function
The business functions owned by a department or unit -
Owned Business
Services
The business services owned by a department or unit -
Table ‎10-6: The properties of organization chart
4. Define the business functions(BRM)
In this step, the EA Core team and working teams have to analyze and document important
architecture elements together – Business Areas, LoBs, Business functions and sub-business
functions. It is highly recommended that the team member with the most experience and
knowledge in the Saudi government roles, functions and processes lead this exercise. Figure
10-4 illustrates the relationships among the various elements in BA.
Review the business areas in the BRM. Ensure that the current business areas identified are
still relevant. The team members may want to check if there added new accountabilities or
186
National Overall Reference Architecture (NORA) – Handbook
responsibilities for the government agency mentioned through royal decrees or government
official announcements as these may affect this review process.
For each business area, review all the relevant LoBs that the government agency is responsible.
Refer to the government agency’s BRM. Ensure and verify that the list of LoBs in the BRM are
correct. Note that nearly all government agencies would have LoBs in different business areas.
It is important that the team comb all the LoBs in the NEA BRM as a verification exercise.
For each LoB, the EA Core team and working teams have to document all the business functions
within the respective LoBs. While the BRM may list some of these business functions, the team
has to verify and add other missing business functions if any. This exercise would ensure that all
the government functions are documented – both primary and secondary. As a guide to verify
the business functions, the team can review the top 4 levels of the organization chart includ-
ing all the divisions and departments. It is a norm to have a range between 10 and 30 business
functions for a government agency.
Within each business function, the team now has to analyze and list all the sub-business func-
tions. These are finer grain descriptions about the business function. A business function nor-
mally has 2 or more sub-business functions. The team can review the organization chart as a
guide - especially at levels 5 and lower where all the units, branches and teams are define. A
government agency typically has 40 to 100 sub-business functions. Document all the business
functions and sub-business functions in the example format below.
Figure ‎10-5: Business area, LoB, business function and sub-business function diagram example
187
National Overall Reference Architecture (NORA) – Handbook
Property Description
Relationship
with national
meta model
Name The name of business function -
Description The detail description of this function -
Level
The level of relevant business function such as area,
LOB, function, and sub-function
-
Upper function
The related upper function’s name. ‘Sub-function’
should be related with one of ‘function’
-
Figure ‎10-6: The properties of business function description
5. Define the business processes
Having documented all the business and sub-business functions, the EA Core team and working
teams have to work with the business owner or representatives to analyze and to document all
the business processes within each sub-business function. Note that the NEA and government
agency’s BRM do not have this list of business processes.
Although this is a tedious task, it is important to document all the business processes so that the
government agency can visualize and identify areas of improvements to the various business
functions and sub-functions. This task is also necessary to facilitate the discovery of potential
processes that can be improved or re-engineered to improve the sub-business function or busi-
ness function as a whole. These business process improvements aid the agency’s e-Government
transformation journey. It is highly recommended that the departments or branches responsi-
ble for these sub-business functions dedicate staff to work with the EA Core and working teams.
For a start, the EA Core and working teams have to understand and agree on the following im-
portant definitions:
188
National Overall Reference Architecture (NORA) – Handbook
a.	A sub-business function normally has two or more business processes
b.	A business process consists of a series of business activities carry out to perform a specific
business outcome; it has one or more inputs and one or more outputs
c.	 The business processes, if automated, are supported by one or more IT applications.
Figure 10-6 shows the information about a sub-business function.
Figure ‎10-7: Contents of a sub-business function
Figure 10-7 shows the main information about a sub-business function using one of MOE’s
examples. Note that this is for illustrative purpose only and does not contain the full updated
information. In this example, the sub-business function of Licensing Management has four
business processes.
189
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-8: MOE’s sub-business function & business process relationship
Document the sub-business function and its processes as shown in the tables below.
Attribute Description
Sub-Business Function ID B.1.3
Sub-Business Function Name Licensing Management
Sub-Business Function Description Manage the issuance, update and revoke of private
school license
Input •	 Company Registration ID
•	 Payment by requestor
Output Private School Operating Certificate
Application Systems •	 Licensing Portal System
•	 Private Schools Management System
•	 National Shared Payment System
Table ‎10-7: Example of sub-business function description
190
National Overall Reference Architecture (NORA) – Handbook
Process
ID
Process
Name
Process De-
scription
Process
Owner
Input Output
B.1.3-1 Manage Licensing
Rules
Manage and update
the various rules /
conditions relating
to the operating
private schools
Licensing
Management
Director
Updates from
ministries;
royal decrees
Updated set of
rules
B.1.3-2 Register &
Maintain Private
Schools List
Create and Update
list of private
schools
Licensing
Management
Director
Updated set
of rules
Updated Private
Schools List
B.1.3-3 Process Request
for new, update
or terminate
Review and ap-
prove or reject the
request for a new /
update / terminate
private school
Licensing
Management
Director
Request Approved
request
B.1.3-4 Issue or Revoke
License
Print and issue physi-
cal license;
Remove and revoke
physical license
Licensing
Management
Director
Approved
request
New license or
revoke license
Table ‎10-8: Business process description example
191
National Overall Reference Architecture (NORA) – Handbook
Document all the activities within each process. The table below is an example of
the activities under ‘Process New Request for Private School’ i.e. B.1.3-3.
Activity
ID
Activity
Name
Activity De-
scription
Activity
Owner
Input Output
B.1.3-3-1 Validate request Check all relevant information
in request
Private Schools
Licensing Officer
Request form Nil
B.1.3-3-2 Verify request Verify request is valid and
correct
Private Schools
Licensing Officer
Request form Nil
B.1.3-3-3 Check for simi-
lar school
Ensure that the proposed
school name is not in use
Private Schools
Licensing Officer
Request form Nil
B.1.3-3-4 Check owner’s
records
Carry out detailed financial
and criminal checks on
owner(s)
Private Schools
Licensing Officer
Proposed
owner’s
national ID
Proposed
owner’s status
B.1.3-3-5 Check curricu-
lum compliance
Check for compliance to
national curriculum
Curriculum Edu-
cation Officer
Proposed
curriculum
plan
Curriculum
compliance
status
B.1.3-3-6 Conduct physi-
cal check
Check proposed private
school environment
Private Schools
Licensing Officer
Proposed
site location
information
Physical location
status
B.1.3-3-7 Decide on
request
Decide to approve or reject Private Schools
Licensing Officer
Outputs from
previous
activities
Decision
Table ‎10-9: Business activity description example
In addition to the activity description above, it is highly recommended to depict the process and
activities in a process map. Figure 10-8 is an example process map.
192
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-9: Business process map example
6. Document the service catalogue
From the list of business processes and activities, the EA Core and working teams can analyze
jointly with the sub-business function owner and process owners to document the services
offered to citizens (G2C), businesses (G2B), employees (G2E) and other government agencies
(G2G). As part of the current business architecture, it is important to know what services
(either electronic or manual) are offered within each sub-business function. This would aid
the government agency to identify areas for business or service transformation.
Typically, a set of business processes will form one distinct service offering by the government
agency. Within a sub-business function, there can be one or more sets of related business
processes, hence one or more services.
It is common mistake to equate business processes to the delivery of services, i.e.  it is a mistake
to equate one business process = one service. Sometimes, even detailed business activities
are regarded as services (for example, a business process may have 5 activities that produce
so-called 5 services). Always view a service from the customer’s perspective, i.e. outcome that
has a value to the customer. Business process and activities on how to carry out the service is
of no concern to the customer, although it is major concern for the business or function owner.
193
National Overall Reference Architecture (NORA) – Handbook
Analyze the business processes and document the services as follows:
a.	Using the business process maps, identify any service offered for each business process (i.e.
output to a stakeholder or customer is usually a service)
b.	Document the service according to its categorization (please see Table 10-9). Ensure that the
format is same or similar, as the service details are required to consolidate for the National
Saudi Government Service Catalogue. Table 10-10 shows an example service catalogue
c.	 Analyze to remove duplicate services across different business processes.
Property Description
Relationship
with national
meta model
Service
ID
Unique service identifier
Business
service(SRS)
Business Service
Name
Name of the business service
Business
service(SRS)
Business Service
Description
Description of the business service
Business
service(SRS)
Service
Type Based on Consumer
Category of the business service, i.e. G2C, G2B, G2G or G2E
Business
service(SRS)
Service Type based On
Granularity
Main Service or Sub Service
Business
service(SRS)
Service Maturity Maturity of Service- Informative, Transactional etc..
Business
service(SRS)
Service Delivery Channel
Mode of the service delivery such as manual, online, kiosk or
combination
Business
service(SRS)
Service Location Location of the Service being delivered.
Business
service(SRS)
Service
Owner
Name or designation of the service owner
Business
service(SRS)
Service Fees The amount charged from consumers of the service
Business
service(SRS)
Service Output
Outputs at the end of the service such as documents, reports and
updated information
Business
service(SRS)
Pre-Requisite Mandatory requirement or condition before the service can start
Business
service(SRS)
194
National Overall Reference Architecture (NORA) – Handbook
Property Description
Relationship
with national
meta model
Service Requirements Supporting documents required to use the service
Business
service(SRS)
Business Process Af-
fected
Zero, one or more services affected by this business process; the
affected services identified by their unique Service ID
Business
service(SRS)
Data Dependency Data required from other agencies to execute the service
Business
service(SRS)
Service Linkage
Is this service utilized by other agencies to execute their own
services
Business
service(SRS)
Servicing Time
Time required to deliver the service to consumer from service
request to the logical end.
Business
service(SRS)
Table ‎10-10: The properties of service catalogue
Using the MOE’s example, there are 2 services rendered under the Licensing Management as
shown in the table below.
Service
ID
Business
Service
Name
Business Service
Description
Service
Category
Service
Owner
Service
Output
Pre-Requisite Service
Mode
Business
Process
Affected
B.1.1 Search for
Private
School (e.g.
by school
name)
Allows public to
search a private
school in KSA. Details
include the location
of the school, school
contact information
and the basic teach-
ing curriculum
G2C /
G2B
Licensing
Manage-
ment
Director
Private
School
details
Nil Online B.1.3.1
B.1.2 Register
and Update
Private
School
Register new private
schools, update infor-
mation about private
schools and the
removal of private
schools. This service
includes the issue of
private school operat-
ing license
G2B Licensing
Manage-
ment
Director
Private
School
Operating
License
Company Regis-
tration Number,
Prior payment
for services
Online
with
manual
checks
and ap-
proval
B.1.3.1,
B.1.3.2,
B.1.3.3,
B.1.3.4
Table ‎10-11: Service catalogue example
195
National Overall Reference Architecture (NORA) – Handbook
7. Document and review
Document all the above information according to the agency’s documentation standards. Do
an internal review and updates. It is also advisable to get another party (especially the business
owner and business teams) to carry out a final review.
8. Obtain Governance Approval
With the completion of the above deliverables, present to the EA Governance Committee. The
Chief Architect or Business Architect should front this presentation. From the comments from
the committee, make the necessary changes to obtain their final approval.
10.4.3 Step 6.3 Analyze and build current application architecture
Application architecture (AA) represents a focal point for a government agency’s IT applications.
It defines how what applications are available, how they support the business and who the
users are. Application architecture will directly help in aligning the government agency business
processes to application systems that support them.
The objective of current application architecture is to describe the application systems & their
relationships that are currently in use by the various business functions. By understanding this
current reality, it gives many opportunities to find areas for business automation, remove
application duplications and improve integration for both business and application systems.
Relationship between Agency AA and Agency ARM
In the previous stage, the team has developed the agency ARM based on NEA ARM. Thus, now
is the time to reference the agency ARM to build the AA.
The agency AA shows the current reality based on the main artifacts of ARM. It describes the
various artifacts or deliverables that reflect accurately the current state in the government
agency in terms of application systems. In short, the AA has more details than the ARM to
depict the actual application system scenarios of the government agency.
196
National Overall Reference Architecture (NORA) – Handbook
The figure below shows the difference between the ARM and AA. As more data and details are
required, there will also be additional artifacts as highlighted in red.
Figure ‎10-10: Difference between ARM and AA
Relationships among Agency AA and other architectures
Table 10-9 summarizes the agency BA relationships with other current architectures.
Other Current
Architectures
AA Relationship
BA AA provides application systems to the various business functions in
the government agency
DA AA requires data model and data elements to be use for decision
making and efficient operations
TA AA provides the requirements for technologies to support the hosting
and usage of application systems
Table ‎10-12: AA relationship with other architectures
197
National Overall Reference Architecture (NORA) – Handbook
The figure below shows the relationships among AA artifacts and the relationships with artifacts
from other architectures.
Figure ‎10-11: AA artifacts’ relationship diagram
Description about the Agency AA
On completion, the current AA will depict the current application landscape of the government
agency. Since the AA is an expansion of the agency ARM, it provides a catalogue of current
applications. The application catalogue and three other additional artifacts or deliverables
provide a comprehensive description of the current AA.
198
National Overall Reference Architecture (NORA) – Handbook
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of AA
2 AA Principles The architectural principles of AA
3 Application Systems (ARM) The main application systems for the agency
4 Application Components
(ARM)
The key application components for the agency
5 Application Interfaces (ARM) The main application interfaces for the agency
6 Application Catalogue The list of applications and their attributes
7 Application Functions The description about the application functions
8 Application Relationships The description about the application relationships
9 Application Overview The overview description of the application systems
Table ‎10-13: AA artifact descriptions
Building the Agency AA
Below table summarizes the main activities for building the agency AA.
S/No Activity Artifact / Deliverable
1 Define the AA purpose or direction AA purpose / direction statement
2 Define the AA principles AA principles
3 Review application systems, application
components and application interfaces
(ARM)
Reviewed / updated application systems,
application components and application
interfaces
4 Document the application overview Application overview
5 Document the application catalogue Application catalogue
6 Document the application functions Application functions
7 Document the application relationships Application relationships
8 Document and review Reviewed draft current AA
9 Obtain governance approval Approved agency current AA
Table ‎10-14: Activities to build AA
199
National Overall Reference Architecture (NORA) – Handbook
1. Define the AA purpose or direction
While the agency ARM provides a good reference to the logical parts of the various applications,
the purpose or direction of the agency AA would describe how these application systems could
actually support the business. Review the ARM purpose, amend and define the AA purpose or
direction.
2. Define AA principles
The AA and ARM principles are similar. The slight difference is that the AA has to describe the
details of the application systems, components and interfaces. In addition, the AA principles
have to address about the application development issues and processes. Hence, it is necessary
to review the agency ARM principles and make minor the necessary changes or additions.
3. Review application systems, application components and application
interfaces (ARM)
From the ARM, review the application systems, components and interfaces. These have been
define to guide the agency in the application development. Simply review all these and make
the necessary additions, amendments and deletions.
4. Document the application overview
The purpose of application overview is to illustrate a high-level representation of all the current
applications within the agency. The application overview should include at least the following
details:
Attribute Description
Relationship with
national meta
model
Application Name The internal name of the application
Application
system(Name)
Category Name
A logical group of the applications. It can be based
on any logical grouping such as being core business
applications or supporting applications
-
Table ‎10-15: The properties of application overview
200
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-12: Application overview example
5. Document the application catalogue
From the application systems, components and interfaces reviewed, the EA Core and working
teams can simply define and document all these information into a structured application cata-
logue. With this application catalogue, it is easy and fast to find all the necessary information about
the various current applications in the agency.
The purpose of this viewpoint is to describe the contextual elements of the application such
as the application modules, application services, development type, maintenance cost, etc. Ap-
plication catalogue is use to identify a list of all the current applications with their details in the
agency. This view should include at least the following attributes:
201
National Overall Reference Architecture (NORA) – Handbook
Property Description
Relationship with
national meta
model
Application Name The internal name of the application Application
system(Name)
Application Description Some details about the application Application
system(Purpose)
Application Type Core business application or support -
Business function List of business function supported by
application
-
Business Owner The Business unit owning the application -
Development Type Externally developed, In-house, out-
sourced, commercial off the shelf, etc.
Application
system(Introduction
method)
Vendor The name of the application’s vendor -
Version Application’s version -
Environment Test, production, development -
Number of Licenses The number of the user licenses of the
application
-
Development language Microsoft .Net, Eclipse Java EE, Oracle
Forms. etc.
Application
system(Development
language)
Related Database The name of the related database -
Hosted Server Name / IP The name or IP address of the server
hosted the application
-
Launch Date The date in which the application be-
came in production
-
Retirement Date The date that the application has been
/ will be retired
-
Total cost The total cost of the application Application
system(Total develop-
ment cost)
Maintenance Cost The annual maintenance cost of the
application
Application
system(Annual main-
tenance cost)
Table ‎10-16: The properties of application catalogue
202
National Overall Reference Architecture (NORA) – Handbook
Below is one example entry of an application catalogue.
Application
Attribute
Description
Application Name Training
Application Descrip-
tion
This application is used for training registration (In-service Training
and Pre Service Training)
Application Type Core business application
Business Service Admission and Registration for In-Service Training
Admission and Registration for Preparatory Training
Business Owner Admin and Registration department
Development Type In-house developed
Vendor Oracle
Version Developer 6i
Environment In production
Number of Licenses N/A
Development lan-
guage
Oracle Forms.
Related Database Hopd5
Hosted Server Name/
IP
Training_Srv/10.10.10.5
Launch Date 11/05/2010
Retirement Date 11/05/2016
Total cost 3.510000 SAR
Maintenance Cost 860000 SAR
Table ‎10-17: Application catalogue example
203
National Overall Reference Architecture (NORA) – Handbook
6. Document the application functions
The purpose of application functions is to identify and describe the functions (activities) per-
formed by the systems in order to depict the relationship between applications and business
functions within the agency. This view is useful when identifying the application systems used
by a particular business function. It also allows the identification of duplicated system functions
among applications. Hence, it allows analysis of duplicated business functions or duplicated ap-
plication systems. The application functions should include at least the following details:
Property Description
Relationship
with national
meta model
Application Name The internal name of the application system
Application
system(Name)
Module / Sub
Module Name
A module/sub module is a software component or
part of a program and in an enterprise-level software
application may contain several different modules,
and each module serves unique and separate business
operations
-
Function Descrip-
tion
The description of the main function of the application /
module/ sub module
-
Table ‎10-18: The properties of application function
204
National Overall Reference Architecture (NORA) – Handbook
The table below is an example of an application function description.
S/
No
Application
Name
Module Name Sub Module Name Function Description
1 Training Trainee system N/A Registration for Training (In-service Training and Pre Service
Training)
2 Planning and
Development
Scholarship
System
 N/A Support faculty members to get higher education (Master and
Ph.D.). All details of faculty member who are going for higher
study, their scholarship etc. are captured in this system
Planning System  N/A Plan annual activities of the organization
205
National Overall Reference Architecture (NORA) – Handbook
S/
No
Application
Name
Module Name Sub Module Name Function Description
3 Business
Human
Resources
Job Positioning Classifies the organization job titles and manages all transactions
Human Resources Personnel System Manages all employee transactions (employment, promotions etc.)
Human Resources Evaluation system Evaluates employee performance
Human Resources Payroll system Processes all payroll and financial claims made by employees
Human Resources Delegation & Banking Controlling  all banking transfers
Human Resources Vacations system Manage and archive all kinds of vacations (normal, emergency,
sick vacation)
Human Resources Housing system Managing all Campus facilities
Human Resources General Query &
statistics
On the basis of query and data, it produces a dashboard to the
decision makers
Human  Resources Cooperative staff Keep all information of Cooperative/Support staff
Human Resources Organization Social
committee
Managing all financial activities of the organization social com-
mittee
Human Resources Residency system Following up all housing residency procedures such as renew-
ing, exit & return forms
Stock Control
System
Purchasing Controlling  all goods requisitions from the organization departments,
verifies the request, asking for vendors quotations, and completing
purchase cycle
Stock Control
System
Inventory Managing all inventory items stock of the organization
Stock Control
System
Stock Control Control all purchasing and inventory procedures of IPA
Stock Control
System
Materials
Assignment
Following up all IPA properties/materials which are assigned to
employees or departments
Stock Control
System
Recruiting system Recruit new employees by conducting entrance examinations
for academic and non-academic jobs. Also accept all online
applications submitted by candidates.
Archiving System
for internal
Document
 N/A The system is used for indexing and scanning all IPA internal
documents
Accounting System  N/A Government Accounting system
Communication
System for incom-
ing letters
 N/A The system is used for incoming letters  from other organization.,
The system is used for indexing and scanning of letters/docu-
ments
Table ‎10-19: Application function example
206
National Overall Reference Architecture (NORA) – Handbook
7. Document the application relationships
The purpose of application relationship is to define relationships among different applications
(internal or external) in order to understand the degree of interaction and the data exchange
among these applications. This view should include the details in the table below.
Property Description
Relationship
with national
meta model
Application Name The internal name of the application
Application
system(Name)
Interacting Application
The name of the interacted application with the first
application
Integration Objective The purpose of the integration
Interface Name / Type
The details of the Integration Interface between the two
applications
Data Entity
The name of the data entity exchanged between the
applications
Data(Name)
Flow
Direction of the relationship (unidirectional or bidirec-
tional)
Frequency The frequency of exchanging data through the interface
Connectivity Type
The type of network connectivity between the two
applications: Internet, LAN, Offline, etc.
Table ‎10-20: The properties of application relationship
Below is an example of application relationship description of the current internal application
integration details.
207
National Overall Reference Architecture (NORA) – Handbook
S/
No
Application
Name
Interacting
Application
Integration
Objective
Interface
Name /
Type
Data
Entity
Flow Frequency
Connectivity
Type
Business
All Applica-
tion
Employee info N/A
Em-
ployee
Data
Out Daily LAN
Training Business
To transfer
money to
student
N/A
Student
Data
Out Daily LAN
Training
Planning and
Development
Info about
training like
how many
training
conducted,
seminars, etc.
N/A N/A Out Daily LAN
Consultation
Planning And
Development
Info about
consultation
and statistics
N/A N/A Out Daily LAN
Table ‎10-21: Application relationship example
8. Document and review
With the completion of the various application documentation, consolidate them into one
structured document according to the agency documentation standards. Carry out an internal
review to verify all the data and artifacts. It is also recommended that an external or third party
(for example application owners) carry out another review. Based on their feedback, make the
necessary improvements.
9. Obtain governance approval
With the completion of the deliverables with the other above related contents, present it to
the EA Governance Committee. The Chief Architect or Application Architect should front this
presentation. From the comments from the committee, make the necessary changes to obtain
their final approval.
208
National Overall Reference Architecture (NORA) – Handbook
10.4.4 Step 6.4 Analyze and build current data architecture
The objective of the current data architecture (DA) is to describe the data entities and structures
used by the business services and business applications. The data architecture describes how
data is processed, stored, and utilized in the government agency. The data architecture is a
crucial component in establishing an overall adaptive environment that enhances and facilitates
data sharing across the agency.
Relationship between Agency DA and Agency DRM
In the previous stage, the team has developed the agency DRM based on NEA DRM. Thus, now
is the time to reference the agency DRM to build the DA.
The DA represents the elements associated with the information in the government agency such
as conceptual data model, logical data model, data entities, databases and other data-related
elements.
The agency DA shows the current reality based on the main artifacts of the agency DRM. It
describes the various artifacts or deliverables that reflect accurately the current state in the
government agency in the use of data. In short, the DA has more details than the DRM to depict
the actual data scenarios of the government agency.
The figure below shows the difference between the DRM and DA. As more details are required,
there will also be additional artifacts as highlighted in red.
209
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-13: Difference between DRM and DA
Relationships among Agency DA and other architectures
Below table summarizes the agency DA relationships with other current architectures.
Other Current
Architectures
DA Relationship
BA DA provides information on agency-wide data and sources of data
from external parties; this aids decisions on data sharing and re-use
AA DA provides data models, database information and data elements
to be use by application systems
TA DA provides the requirements for technologies to support the hosting
and usage of database systems and data exchanges
Table ‎10-22: DA relationship with other architectures
210
National Overall Reference Architecture (NORA) – Handbook
The figure below shows the relationships among DA artifacts and the relationships with arti-
facts from other architectures.
Figure ‎10-14: DA artifacts’ relationship diagram
Description about the Agency DA
On completion, the current DA will depict the current data landscape of the government agen-
cy. Since the DA is an expansion of the agency DRM, it provides a catalogue of data and the data
models currently in use. There will be five additional artifacts in the DA. Together, they give a
comprehensive description of the current data usage in the government agency.
211
National Overall Reference Architecture (NORA) – Handbook
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of DA
2 DA Principles The architectural principles of DA
3 Data Model (DRM) The main data model for the agency
4 Data Classifications (DRM) The key data classifications
5 Data Structure (DRM) The main data structures for the agency
6 Data Exchange (DRM) The list of data exchanges for the agency
7 Conceptual Data Model The pictorial high-level description of data model for
the agency
8 Logical Data Model The logical data models of the agency
9 Data Flow Diagrams The various pictorial representations of data flows for
the agency
10 Database Portfolio Catalogue The consolidation of all databases in the agency
11 Data Dictionary The definitions for common data in the agency
Table ‎10-23: DA artifact descriptions
Building the Agency DA
Table 10-24 summarizes the main activities for building the agency DA.
S/
No
Activity Artifact / Deliverable
1 Define the DA purpose or direction DA purpose / direction statement
2 Define the DA principles DA principles
3 Review data model, data classifications and
data structures (DRM)
Reviewed / updated data model, data classifications
and data structures
4 Create the conceptual data model Conceptual data model
5 Create the logical data model Logical data model
6 Document the data flow diagrams Data flow diagrams
7 Compile the database portfolio catalogue Database portfolio catalogue
8 Document the data dictionary Data dictionary
9 Document and review Reviewed draft current DA
10 Obtain governance approval Approved agency current DA
Table ‎10-24: Activities to build DA
212
National Overall Reference Architecture (NORA) – Handbook
1. Define the DA purpose or direction
While the agency DRM provides a good reference to the high-level data model, data classifications
and structures, the purpose or direction of the agency DA is to describe the actual data usage
landscape. Review the DRM purpose, amend and define the DA purpose or direction.
2. Define DA principles
The DA and DRM principles are similar. The slight difference is that the DA has to provide more
information about the actual data landscape in the government agency. Hence, review the DRM
principles and amend them to catalyze the development of agency-wide data landscape.
3. Review data model, data classifications and data structures (DRM)
From the DRM, the EA Core and working teams have to review the data model, data classifications
and data structures. Add, amend or delete the information if required. This information will be
required for the next few activities.
4. Create the conceptual data model
A conceptual data model identifies the highest-level relationships between the different data
entities using ERD notation with at least the following details:
Property Description
Relationship
with national
meta model
Data Entity The name of the data entity exchanged be-
tween the applications
Data(Name)
Entity Relationship The relationship between data entities   and
the multiplicity
-
Table ‎10-25: The properties of conceptual data model
213
National Overall Reference Architecture (NORA) – Handbook
Below is an example of a conceptual data model.
Figure ‎10-15: Conceptual data model example
5. Create the logical data model
A logical data model describes the data in more detail, without regard as to how they will be
physical implemented in the database. Features of a logical data model include:
Property Description
Relationship with national
meta model
Data Entity The name of the data entity Data(Name)
Entity Relationship The relationship between data
entities
-
Attributes All the attributes of the entity -
Primary Keys A list of the primary key(s) -
Foreign Keys A list of the foreign key(s) -
Table ‎10-26: The properties of logical data model
214
National Overall Reference Architecture (NORA) – Handbook
The figure below is an example of a logical data model. Draw the logical data model for the agency.
Figure ‎10-16: Logical data model example
6. Document the data flow diagrams
Data flow diagram represents both input and output information from the application systems.
It also shows the data storage locations, data sources and data destinations. Through pictorial
diagrams, it is efficient and easy to gather information on data supplier and consumer, including
the transformation points of the data.
From the logical data model, analyze the inputs and outputs to each data entity. Map the data
stores, inputs and outputs into the business processes developed in BA. The table below is
example of attribute descriptions, while the figure is an example data flow diagram. Finally,
draw all the relevant data flow diagrams.
215
National Overall Reference Architecture (NORA) – Handbook
Property Description
External Entity (Input /
Output)
An external entity can represent a human, system or subsystem.
It is the data source or destination.
Process (Function) A process is a business activity or function where the manipula-
tion and transformation of data takes place.
Data Store A data store represents the storage of persistent data required
and/or produced by the process. Data entity and database table
are the examples of data stores.
Data Flow A data flow represents the flow of information, with its direction rep-
resented by an arrowhead that shows at the end(s) of flow connector.
Table ‎10-27: The properties of data flow diagram
Figure ‎10-17: Data flow diagram example
216
National Overall Reference Architecture (NORA) – Handbook
Compile the database portfolio catalogue
The purpose of database portfolio catalog is to identify the databases use by application sys-
tems (listed in current AA). This artifact also provides the logical mapping between related data
elements that is very useful in depicting the holistic view of the enterprise architecture. The
database catalogue should include at least the following details:
Property Description
Relationship
with national
meta model
Database Name of database use by application systems -
Description High level database description -
DBMS Information Some details regarding the database management system
(Oracle DB, Adabas, DB2, MySQL, etc.)
-
Server Name / IP The name or the IP address of the database server -
Database Size The size of the database -
Backup Info Frequency of the backup and data backup recovery plan -
Business Criticality Business criticality of the database (e.g. very critical, normal,
low)
-
Business Owner / Unit The data owner -
Table ‎10-28: The properties of database portfolio catalogue
For each of the logical data model, identify the corresponding database(s). Document all the
details in the database portfolio catalogue as shown in the example below.
217
National Overall Reference Architecture (NORA) – Handbook
The table below provides a general example of the database details view.
S/No Database
Name
Description DBMS Info Server
Name/IP
Database
Size
Backup Info Business
Criticality
Business
Owner / Org
Unit
1 Special
Training DB
This database is
central repository
for all data related
elements of special
training
Oracle
10gR2, 9i
in J and D
172.20.1.36 10 GB Weekly backup
(Cold Backup)
and there is no
recovery plan
exists
Critical
Special Train-
ing Dept.
2 English
Training DB
This database is
central repository
for all data related
elements of English
training
Oracle
10gR2, 9i
in J and D
172.24.8.14 2 GB Weekly backup
(Cold Backup)
and there is no
recovery plan
exists
Critical
English
Learning
Centre
3 Library DB This database is
central repository
for all data related
elements of the
library.
Oracle
10gR2, 9i
in J and D
172.20.1.36 10 GB
N/A Average
Library Dept.
Table ‎10-29: Database catalogue example
8. Document the data dictionary
The purpose of the data dictionary is to define the data attributes regardless of the physical
storage or form. As data dictionary defines all the common data elements, it is useful in
confirming data requirements for business and other data exchanges. The data dictionary
provides a comprehensive description of each data element as shown below.
218
National Overall Reference Architecture (NORA) – Handbook
Property Description
Relationship
with national
meta model
Data Entity The name of each entity (also called a table) Data(name)
Description A description of the data entity Data(description)
Attribute name The name of each attribute name -
Attribute description A description of the data attribute -
Primary / Foreign Key Identification of primary and foreign key of each
attribute
-
Data Type The data type of each field (text, image, date , etc.) -
Field Size The maximum length of the field -
Mandatory Whether this attribute is mandatory or not(Yes/no) -
Table ‎10-30: The properties of data dictionary
From both the logical data model and database portfolio catalogue, the team has to analyze and
list all the data elements. Describe the data elements as shown in the table below.
219
National Overall Reference Architecture (NORA) – Handbook
Property Description
Data Entity Product
Description An item in the catalogue of products that are available for purchase by a customer
Property Description
Attribute name Product Number
Attribute description The unique identifier of the item in the catalogue
Primary / Foreign Key Primary Key
Data Type Integer
Field Size 00000000 to 99999999, always 8 digits including
leading zeroes
Mandatory Yes
Attribute name Description
Attribute description Short description of the product for customer
consumption
Primary / Foreign Key No
Data Type Character
Field Size min:1, max:256
Mandatory No
Attribute name Unit Cost
Attribute description The current list price of the product
Primary / Foreign Key No
Data Type Currency
Field Size SAR max 100,000,000,000
Mandatory Yes
Table ‎10-31: Data dictionary example
220
National Overall Reference Architecture (NORA) – Handbook
9. Document and review
Upon completion of the above deliverables, document all the relevant information into a structured
DA document base on the government agency’s documentation standards. Carry out an internal
review and appropriate updates. It is also a good practice to get an external party to review the
DA document such as DBAs and business owners.
10. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to the EA
Governance Committee. The Chief Architect or Data Architect should front this presentation. From
the comments from the committee, make the necessary changes to obtain their final approval.
10.4.5 Step 6.5 Analyze and build current technology architecture
The technology architecture (TA) describes the software and hardware capabilities that are
required to support deployment of business, data, and application services. This includes ICT
infrastructure, middleware, networks, and communications among others. The main objective
of the current TA is to map a set of technology components - which represent software and
hardware components – into a structured pictorial and descriptive view of the technologies in
use by the government agency.
The TA provides the detailed description of the technology-related elements and this section
addresses the technology domain in the Enterprise Architecture, their purpose template,
example and linkages.
Relationship between Agency TA and Agency TRM
In the previous stage, the team has developed the agency TRM based on NEA TRM. Thus, now
.is the time to reference the agency TRM to build the TA
In essence, the TA is derive from the TRM. However, the main difference is the application of the
various artifacts or deliverables to reflect accurately the current state in the government agency.
In other words, the TA has more details to depict the actual physical technology scenarios of the
government agency.
221
National Overall Reference Architecture (NORA) – Handbook
The figure below shows the difference between the TRM and TA. As more data and details are
required, there will also be additional artifacts as highlighted in red.
Figure ‎10-18: Difference between TRM and TA
Relationships among Agency TA and other architectures
As the EA Core and working teams have already developed other current architectures, it is
important to understand their inter-relationships as summarized in below table.
Other Current
Architectures
TA Relationship
BA TA provides the client and office technologies such as PCs, mobile
devices, printers and scanners to the agency employees in different
branches and divisions
AA TA provides the infrastructure technologies to host and support ap-
plication systems and components
DA TA provides the infrastructure technologies to enable data transac-
tions and exchanges
Table ‎10-32: TA relationship with other architectures
222
National Overall Reference Architecture (NORA) – Handbook
The figure below shows the relationships among TA artifacts and the relationships with artifacts
from other architectures.
Figure ‎10-19: Relationship TA artifacts
Description about the Agency TA
On completion, the current TA will depict the current technology landscape of the government
agency. Since the TA is an expansion of the agency TRM, the following are the artifacts or
deliverables. Note that there are four additional artifacts or deliverables. Collectively, they will
provide a comprehensive description of the current TA.
223
National Overall Reference Architecture (NORA) – Handbook
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of TA
2 TRM Principles The architectural principles of TA
3 Service Area (TRM) The highest level technology service area
4 Service Category (TRM) The technology service category within a service area
5 Service Standard (TRM) The list of technology service standards in use
6 Infrastructure Overview The high-level representation of IT landscape in the government
agency (normally in diagrammatic form)
7 Infrastructure Description The descriptions of the main infrastructure technologies in use
8 Hardware Catalogue The current list of hardware
9 Software Catalogue The current list of software
Table ‎10-33: TA artifact descriptions
Building the Agency TA
Below table summarizes the main activities for building the agency TA.
S/No Activity Artifact / Deliverable
1 Define the TA purpose or direction TA purpose / direction statement
2 Define the TA principles TA principles
3 Review the service areas and service
categories (TRM)
Reviewed service categories within service areas for the agency
4 Review the service standards (TRM) Reviewed service standards within each service category relevant
for agency
5 Analyze the data collected Nil
6 Describe the infrastructure overview High-level representation of IT landscape in agency
7 Provide the infrastructure descriptions List of infrastructure technology descriptions in use
8 Develop the hardware catalogue List of hardware in use
9 Develop the software catalogue List of software in use
10 Document and review Reviewed draft current TA
11 Obtain governance approval Approved agency current TA
Table ‎10-34: Activities to build TA
224
National Overall Reference Architecture (NORA) – Handbook
1. Define the TA purpose or direction
The TA and TRM purposes are alike. The difference is that the TA purpose can show actual
outcomes directly. Review the TRM purpose, amend and define the TA purpose or direction.
2. Define TA principles
The TA and TRM principles are similar. The difference lie mainly in the operational implementation
of technologies such as performance, sharing of physical assets and security controls. Review
the TRM principles, amend and define the TA principles.
3. Review the service areas and service categories (TRM)
Review the service areas and categories to ensure that these are correct and relevant.
4. Review the service standards (TRM)
Review the service standards defined in TRM. If the TRM was developed long time back (for
example more than three years ago), there may be a need to even review the service categories.
Review all the service standards and make the necessary updates.
5.Analyze the data collected
The data collected should minimally be grouped to the appropriate service standards such as web
browsers (Internet Explorer, Google Chrome), platform dependent (Windows), platform independent
(J2EE, Linux), application servers, portal servers, databases (DB2, Oracle, MySQL), Storage (NAS, SAN,
Cloud), LAN and WAN. Analyze the data to understand the trends or patterns in technology usage.
6. Describe the infrastructure overview
The purpose of this overview is to provide a high-level representation of the IT infrastructure
in the government agency and to develop a comprehensive view of the current infrastructure
components such as the headquarter network and the connected branches, the internet
connectivity, servers farm , LAN, WLAN, communications links, etc. The data collected and
analyzed should be summarized into this infrastructure overview.
225
National Overall Reference Architecture (NORA) – Handbook
Provide a pictorial infrastructure overview highlighting the technology components in various
service standards. A example artifact is shown in the figure below.
Figure ‎10-20: Infrastructure overview example
226
National Overall Reference Architecture (NORA) – Handbook
7. Provide infrastructure descriptions
The purpose of IT infrastructure descriptions is to provide all the details needed to describe the
current infrastructure components or service standards such as LAN, WAN, Internet, storage and
servers. This view should include at least the following details listed in the table below.
Property Supporting Document
WAN WAN logical diagram
The description about the WAN connectivity at the organization should include but not
limited to the followings:
Number of WAN links , speed of the links ,WAN technology (VPN-MPLS...), name of the
internet service provider (ISP), details of WAN link redundancy ,connected branches
details, GSN connection, Firewall setup details, etc.
LAN LAN logical diagram
The description about the LAN inside the organization should include but not limited to
the followings:
Number of current users (PCs), LAN Speed , service available for each user, VLANs, IP
addressing scheme, links type, access switches details, and etc.
Internet Internet connectivity diagram
The description about the internet connectivity should include but not limited to the
followings:
Internet service provider (ISP) details, link speed and utilizations, load balancer details
and etc.
WLAN Wireless connection diagram inside the agency
The description about the wireless connection should include but not limited to the
followings:
Wireless access setup,  wireless access points details, encryption details , etc.
Storage Storage solutions diagram
The description about the storage details should include but not limited to the followings:
Storage infrastructure details, backup descriptions, storage capacity , utilization, and etc.
Server Server farm diagram
The description about the server farm details should include but not limited to the
followings:
Number of servers used, connections details, and etc.
Table ‎10-35: The properties of infrastructure descriptions
227
National Overall Reference Architecture (NORA) – Handbook
WAN
Figure ‎10-21: WAN diagram example
Description The organization has only one branch connecting to the headquarter
through (IP/VPN) of STC. Branch office of Jeddah is accessing Riyadh head
office network and system through this VPN connection (30 Mbps) using
Cisco 1800 integrated services routers installed at both ends without
redundancy. This router connect to a firewall (Juniper / SSG550) to
protect the organization’ network .The connection to Yessers’ GSN is
through a dedicated router provided and managed by Yesser and is protected
by firewalls on both ends.
228
National Overall Reference Architecture (NORA) – Handbook
LAN
Figure ‎10-22: LAN diagram example
Description
Riyadh head office has client server architecture and there are 1424 users (PCs)
to access the infrastructure facility Cisco 3750G PoE stack switches acting as floor
access switches to provide connectivity to the users and nodes. All access switches
via UTP cable are aggregated to the distribution switch (Cisco 4507) at each building
that have 10 Gbps uplink to the Core switch (Cisco 6509) at  the data center . The
IP schemas used at the organizations for the servers : 172.16.0.0/16, and for the
clients: 172.18.0.0/16.
229
National Overall Reference Architecture (NORA) – Handbook
Internet
Figure ‎10-23: Internet diagram example
Description
The Internet connectivity is provided by two service providers (STC and Mobily)
through two 20 Mpbs links. Access to the Internet from the organization takes place
through a Microsoft Websense Proxy Server and Web Filter that connects to dual
F5 Load Balancers which provide safe and continues internet browsing capabilities.
230
National Overall Reference Architecture (NORA) – Handbook
WLAN
Figure ‎10-24: WLAN diagram example
Description
The current wireless access setup is comprised of a master controller (Aruba
3600) and 73 wireless access points distributed throughout the organization.
Data transmission in the wireless network is secured using WPA2 AES encryption.
The Clearpass 500H is currently being configured to integrate with the Active Directory
for access permissions.
231
National Overall Reference Architecture (NORA) – Handbook
Storage
Figure ‎10-25: Storage diagram example
Descrip-
tion
Following are the details of the organization storage:
•	 Two EMC SAN Storage: EMC VNX5300 with maximum capacity of 360TB and the
utilization is 23%.
•	 Two MDS Switch: Cisco MDS 9124 multilayer fabric switch with high availability.
As a backup solution, the agency  is currently using the Snap Vault solution from Net
App to perform Disk-to-Disk backups (D2D) every day. Jeddah branch currently used as
disaster recovery site (DR).
232
National Overall Reference Architecture (NORA) – Handbook
Server
Farms
Figure ‎10-26: Server farm diagram example
Description The server farm typically hosts the most important IT assets in the organization;
it is connected directly to the core switch cisco 4500 .The current technology
infrastructure at the organization  utilizes a total of 73 physical servers (62 in the
primary datacenter in Riyadh, and 11 in the DR datacenter in Jeddah . All servers
come with multiple 1GB Ethernet cards, and some servers have converged
network adapters (CNA) allowing them to connect to the SAN. Also the organization
is deploying a VMware virtualization solution. The current virtualization includes 16
SUN/Intel-based servers with 2 CPU/16GB or 2CPU/32B specs. The virtualized en-
vironment currently runs more than 23 different applications. The utilization for all
the servers (virtual and physical) are not exceed 50%.
8. Develop the hardware catalogue
The purpose of the hardware catalogue is to provide a  list of hardware components in use
across the agency including servers, switches, storages, routers, firewalls, load balancers, wireless
access point, IPS, IDS, etc.
Based on the data collected, develop the hardware catalogue with the following minimum
details as shown in the example below.
233
National Overall Reference Architecture (NORA) – Handbook
Property Description
Relationship
with national
meta model
Hardware  Name The internal  name of this component Hardware (Name)
Hardware Type The type of the hardware (server , switch , router , storage,
firewall, controller , wireless access point ,load balancer, etc.)
Hardware (Type)
Model Number The manufacturers model such as cisco 2960x, HP Proliant
460C, NetApp FAS2050, f5 3600 etc.
Hardware (Model Name)
Description Detail description for this component (purpose, functions, ) -
Vendor The manufacturer of the device Hardware (Vendor)
Application Name Business application hosted or supported by this device Application system
(Name)
Location The location details of this device
OS Name The name of the operation system running Hardware(OS name)
IP address The IP address of this device -
Processors details Some details of the device processors (number and speed) -
Capacity details The maximum capacity this device can accommodate. -
Usage details The current usage details of this device -
Connectivity
details
Some details about the device connectivity to the network -
Introduction date The started date in which this device is used Hardware
(Introduction year)
Retirement Date The date that the device will be retired -
Business severity The severity of business impact such as mission critical,
critical, medium, and low
Hardware
(Business severity)
Total cost Total cost of the hardware installation Hardware(Total cost)
Maintenance Cost The annual maintenance cost of the hardware if applicable
Hardware (Annual main-
tenance cost)
Table ‎10-36: The properties of hardware catalogue
234
National Overall Reference Architecture (NORA) – Handbook
Hardware Description
Hardware  Name Training Server
Hardware Type Server
Model Number Blade HP Proliant 460C Gen8
Description This server host one of the core applications called the training system.
Vendor HP
Application Name Training
Location DC in Riyadh (Basement floor- Cabinet#1)
OS Name Windows 2000 Advanced Server -SP4
IP address 172.16.16.99
Processors details 2 processors (8 core, 2 GHz, 20MB, 95W)
Capacity details 2 x 300 GB (RAID1)
Usage details 19% of the max capacity used.
Connectivity details 1 GB NIC connected to the core switch cisco 4500
Introduction date 10/2013
Retirement Date N/A
Business severity Low
Total cost 18500 SAR
Maintenance Cost N/A
Table ‎10-37: Hardware catalogue example
235
National Overall Reference Architecture (NORA) – Handbook
9. Develop the software catalogue
The purpose of the software catalogue is to provide a list of software components in use across
the agency such as OS, productivity tools, middleware, security tools and network management
tools (NMS).
Based on the data collected, develop the software catalogue with the following minimum de-
tails as shown in the example below (which is for only one component).
Property Description
Relationship with
national meta model
Product/Software
Name
Name of software named by its manufacturer Software
(Name)
Software Type The type of the software (OS, security tool, middle-
ware, NMS, mail, DBMS, productivity tool, etc.)
Software
(Type)
Model / Version Software version/model Software
(Name of SW)
Description Some description about this component
purpose, function…)
-
Vendor Name of software manufacturer Software
(Vendor)
License details Software’s license management policy (users, PCs,
servers, etc.)
Software
(License Policy)
Business Unit Business units supported by this software -
Hosting Hardware
Name/IP
The name of the hosted server -
Number of current
users
Number of current users using this software -
Introduction date the year when the software is installed Software
(Introduction year)
Total cost Total cost of the software installation Software
(Total cost)
Annuala
Maintenance Cost
The cost of SW annual maintenance cost Software
(Annual maintenance cost)
Table ‎10-38: The properties of software catalogue
236
National Overall Reference Architecture (NORA) – Handbook
Product/Software
Name
Description
Software Type Network Monitoring Software
Model / Version PRTG - Version 15.4.21
Description PRTG Network Monitor runs on a windows machine within the
network, collecting various statistics from the machines, software,
and devices in order to generate performance reports
Vendor Paessler AG
License details The licensing are based on the number of sensors (unlimited)
Business Unit IT Department
Hosting Hardware Name/IP NMS-Srv  / 172.16.16.71
Number of current users N/A
Started date 9/2015
Total cost 89,000 SAR /year including the maintenance cost
Annual Maintenance Cost N/A
Table ‎10-39: Software catalogue example
10. Document and review
After drafting all the definitions and standards, document all the relevant information into a
structured information base on the agency’s documentation standards. Do an internal review
and updates. It is also advisable to get another party (especially the technology and operations
teams) to carry out a final review.
11. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to the
EA Governance Committee. The Chief Architect or Technology Architect should front this pre-
sentation. From the comments from the committee, make the necessary changes to obtain
their final approval.
237
National Overall Reference Architecture (NORA) – Handbook
10.4.6 Step 6.6 Current architecture analysis
It is a major accomplishment milestone on the completion of capturing the current architectures.
With the information and pictorial representations, the EA Core and working teams can have
different perspectives about the government agency on the business, applications, data and
infrastructure. These current architectures also allow the discovery of not so obvious linkages,
dependencies, and even synergies or integrated components. On the other hand is a milestone
unlike any, this is because it performs many important aspects including but not limited to the
following. The advantage of viewing the whole of enterprise cutting across silos, establishing
the obvious and not so obvious linkages and dependencies, capturing of synergies etc. facilitate
identification of opportunities for progress of the agency as well as the issues that are hindering
its future growth.
The current architecture analysis is an activity to understand current issues and challenges of
the government agency on one hand, and to explore ideas for improvement and integration on
the other hand.
The following describes important activities for this step.
S/
No
Activity Artifact / Deliverable
1 Analyze BA BA improvement opportunities
2 Analyze AA AA improvement opportunities
3 Analyze DA DA improvement opportunities
4 Analyze TA TA improvement opportunities
5 Document and review Reviewed draft summary of improvement
opportunities
6 Obtain governance approval Approved agency summary of improvements
Table ‎10-40: Activities to analyze current architectures
238
National Overall Reference Architecture (NORA) – Handbook
1.Analyze BA
Review the current BA.
A recommended method is to compare the BA artifacts against the agency’s mission and vision
statements, strategic goals / objectives, the agency annual plans, the Saudi e-Government Plan,
the agency PRM  and the agency e-transformation plan (if any). The EA Core and working teams
can also use analysis tools such as Value Chain analysis, 7S analysis, SWOT analysis and business
process simulation. Carry out the following activities:
a.	List the main issues and challenges faced in BA
b.	Analyze the business functions and services by logical and physical dimensions
c.	 List the prioritized strategic business outcomes
d.	List the key business work activities or functions, and how they have to improve based on (a)
and (c)
e.	 Using the BA principles as a guide, define specific improvement opportunities for the list in (d).
Figure ‎10-27: Example BA analysis
239
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-28: Example BA improvement opportunities
2.Analyze AA
Review the current AA.
A recommended method is to compare the AA artifacts against the strategic goals / objectives,
the agency annual plans, the Saudi e-Government Plan, the agency PRM, prioritized application
list (from agency ARM) and the agency e-transformation plan (if any). The EA Core and working
teams can also use SWOT analysis. Carry out the following activities:
a.	List the main issues and challenges faced in AA
b.	Identify some of the global trends in application systems
c.	 Analyze the application systems by categories and departments / branches; also analyze the
required application systems to support the BA improvement opportunities
d.	 List the prioritized application systems, components and interfaces for development, replacement,
amendment and retirement
e.	Using the AA principles as a guide, define specific improvement opportunities for the list in (d).
240
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-29: Example AA analysis
Figure ‎10-30: Example AA improvement opportunities
241
National Overall Reference Architecture (NORA) – Handbook
3.Analyze DA
Review the current DA.
A recommended method is to compare the DA artifacts against the agency annual plans, the
Saudi e-Government Plan, the agency PRM and the agency e-transformation plan (if any). The
EA Core and working teams can also use analysis tools such as data dependency and SWOT
analysis. Carry out the following activities:
a. List the main issues and challenges faced in DA
b.	Identify some of the global trends in data management and data usage
c.	 Analyze the data represented by logical and physical dimensions; also analyze the required
data to support the AA improvement opportunities
d.	List the prioritized strategic data models, data elements and databases
e.	 Using the DA principles as a guide, define specific improvement opportunities for the list in (d).
Figure ‎10-31: Example DA analysis
242
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-32: Example DA improvement opportunities
4.Analyze TA
Review the current TA.
A recommended method is to compare the TA artifacts against the agency annual plans, the
Saudi e-Government Plan, the agency PRM and the agency e-transformation plan (if any). The
EA Core and working teams can also use analysis tools such as data dependency and SWOT
analysis. Carry out the following activities:
a.	List the main issues and challenges faced in DA
b.	Identify some of the global technology trends and technology standards
c.	 Analyze the infrastructure and other technologies; also analyze the required technologies
required to support the BA, AA and DA improvement opportunities
d.	List the prioritized strategic technologies for development; also include technologies that
require to be replaced or retired
e.	Using the TA principles as a guide, define specific improvement opportunities for the list in (d).
243
National Overall Reference Architecture (NORA) – Handbook
Figure ‎10-33: Example TA analysis
Figure ‎10-34: Example TA improvement opportunities
244
National Overall Reference Architecture (NORA) – Handbook
5. Document and review
After completing all the analysis, consolidate all the improvement areas and document them
into a structured information base on the agency’s documentation standards. Perform a cross-
domain analysis (BA, AA, DA, TA), to identify and document more opportunities for improve-
ment. Do an internal review and updates. It is also advisable to get other parties – business
owners, application developers, DBAs and data owners, and the infrastructure team - to carry
out a final review.
6. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to the
EA Governance Committee. The Chief Architect should front this presentation. From the com-
ments from the committee, make the necessary changes to obtain their final approval.
245
National Overall Reference Architecture (NORA) – Handbook
Stage7–BuildTarget
Architecture
246
National Overall Reference Architecture (NORA) – Handbook
11. Stage 7 – Build Target
Architecture
11.1 Stage summary
With the completion of the government agency’s current architectures, this stage develops the
target architectures. As a blueprint for the government agency to realize its goals and desired out-
comes in 3 to 5 years, the target architecture defines the improved business and IT landscapes.
The detailed analysis will lead to the development of target architectures that include Business
Architecture, Application Architecture, Data Architecture and Technology Architecture. The
government agency may build all the target architectures or selective relevant architectures
depending on its EA scope and development strategy.
11.2 Stage purpose
The purpose of this stage is to analyze, design and document the target government agency’s IT
and business landscapes. The expected outcomes or deliverables of this stage are:
1.	Target Business Architecture
2.	Target Application Architecture
3.	Target Data Architecture
4.	Target Technology Architecture.
Note that the above are recommended outcomes. A government agency can have more or less
architectures depending on its EA scope, goals, EA framework design and development strategy.
Other examples not listed above include target security and performance architectures.
247
National Overall Reference Architecture (NORA) – Handbook
11.3 Stage initiation
With the completion of the previous stages, the EA Core Team and working teams have to en-
sure that the following deliverables are in place:
1.	Summary of Improvement Opportunities
2.	Current Business Architecture
3.	Current Application Architecture
4.	Current Data Architecture
5.	Current Technology Architecture.
As mentioned above, depending on the EA scope and development strategy, the government agency
has to ensure that the corresponding current architectures are completed. If the government agency
intends to build all architectures, then it needs the five above current architectures. However, if
the government agency is doing a specific EA scope such as data and technology consolidation,
then it needs to have at least the data and technology architectures in place.
11.4 Key steps in stage 7
Below table list the key activities and expected deliverables for stage 7.
248
National Overall Reference Architecture (NORA) – Handbook
Stage /
Step No
Description Deliverable
7 Build Government Agency’s Target Architectures
7.1 Define directions for developing target architecture
by analyzing environmental factors such as agency’s
vision/principles, current architectures etc.
Target Architecture direction
7.2 Analyze and build the target business architecture
based on architecture principles, current business ar-
chitecture’s analysis result, and current business ar-
chitecture deliverables.
Government Agency’s target
Business Architecture
7.3 Analyze and build the target application architecture
based on architecture principles, current application
architecture’s analysis result, and current application
architecture deliverables.
Government Agency’s target
Application
Architecture
7.4 Analyze and build the target data architecture based
on architecture principles, current data architecture’s
analysis result, and current data architecture deliver-
ables.
Government Agency’s target
Data Architecture
7.5 Analyze and build the target technology architecture
based on architecture principles, current technology
architecture’s analysis result, and current technology
architecture deliverables.
Government Agency’s target
Technology
Architecture
Table ‎11-1: Stage 7 steps
11.4.1 Step 7.1 Define directions for developing target architecture
In the previous stage, the team has built or documented the current architecture and analyzed
current architecture issues. One of the outputs from the previous stage is the Summary of
Improvement Opportunities. The EA Core and working teams have also previously analyzed
agency’s vision/purposes & other environmental factors, and then, based on them, we can
define target architecture’s directions. The table below lists the activities in defining directions
for target architecture.
249
National Overall Reference Architecture (NORA) – Handbook
S/
No
Activity Artifact / Deliverable
1 Review agency EA vision and principles Reviewed agency EA vision and principles
2 Review environment and requirements analysis Nil
3 Review current improvement opportunities Nil
4 Summarize target architecture directions Target architecture directions
5 Document and review Reviewed draft target architecture directions
6 Obtain governance approval Approved target architecture directions
Table ‎11-2: Activities for defining target architecture directions
1. Review agency EA vision and principles
Review the EA vision that agency desires to reach and review principles to build an architecture
on, and get some implications to develop agency’s target architecture.
Figure ‎11-1: Example of EA principles review and its implications
250
National Overall Reference Architecture (NORA) – Handbook
2. Review environment and requirements analysis
Review the environment and EA requirements analysis done in the early stages. These would
provide the overall scope and priority areas in the EA development. Analyze and gauge the need
for adjustments or changes.  Thus, this will ensure that architecture directions would be aligned
with the overall agency EA purpose.
3. Review current improvement opportunities
From the detailed review of opportunities done in the previous stage, identify improvement
opportunities in each architecture area (business, application, data, technology). It would be
good to consider the implications of these improvements to the government agency. The EA
Core and working teams should review other strategies such as KSA 2030 Vision and the Saudi
e-Government Action Plan. It is also important to review the agency PRM to help in setting
performance measurements. Combine all these inputs to develop all the potential opportunities.
Prioritize these opportunities based on the above reviewed principles and environment analysis.
Finally, consider and plan the implementation of these opportunities so they can meet the
agency’s strategic goals or outcomes.
Figure ‎11-2: Example agency improvement opportunities for various architectures
251
National Overall Reference Architecture (NORA) – Handbook
4. Summarize target architecture direction
Summarize and organize findings such as agency’ EA vision, principles, etc., and analysis results,
and define EA directions for building target architecture (as to business, application, data, and
technology).
Figure ‎11-3: Example of target architecture direction through overall analysis
5. Document and review
Document all the information above into a summary with clear recommendations on the target
architecture directions and the high-level schedules aligned with KSA and agency’s strategic
targets. Carry out an internal review. It is also recommended that another party (for example
the agency Strategic Planning Unit) review these target directions.
6. Obtain governance approval
Present the summarized target architecture directions to the EA Governance Committee. Note
that this will be the first useful EA output that the EA Governance will see. Thus, expect some
questions and more ideas from the committee members. From their feedback, make the necessary
updates and obtain their approval.
252
National Overall Reference Architecture (NORA) – Handbook
11.4.2 Step 7.2 Build target business architecture
Description about the agency target BA
On completion, the target BA will depict the future business landscape of the government agen-
cy. Since the target BA is the future version of the current BA, both have the same artifacts or
deliverables. The main difference is that the target BA describes about the future scenarios –
i.e. providing solutions to the current issues and challenges.
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of BA
2 BA Principles The architectural principles of BA
3 Business Areas (BRM) The main business areas for the agency
4 Lines of Business (BRM) The main LoBs for the agency within the business areas
5 Business Functions (BRM) The key business function descriptions within LoBs
6 Sub-Business Functions (BRM) The sub-business function descriptions within each
business function
7 Business Processes The target list of business process descriptions within
each sub-business function; highlight new, improved
and deleted processes
8 Organization Chart The target organization chart for the agency
9 Service Catalogue The target list of business services; highlight new,
improved or deleted services
Table ‎11-3: Target BA artifact descriptions
Building the agency target BA
Table 11-3 summarizes the main activities for building the agency target BA.
253
National Overall Reference Architecture (NORA) – Handbook
S/
No
Activity Artifact / Deliverable
1 Review the BA purpose or direction and BA
principles
Reviewed / updated BA purpose or direction
statement
2 Review the BA principles Reviewed / updated BA principles
3 Define the target business functions (BRM) Reviewed / updated business areas, LoBs,
business functions and sub-business func-
tions
4 Define the target business processes List  of target improved business processes
for the agency
5 Define the target service catalogue Target service catalogue
6 Document the target organization information Target organization chart
7 Document and review Reviewed draft target BA
8 Obtain governance approval Approved agency target BA
Table ‎11-4: Activities to build target BA
Using the target architecture directions as an input, do the following:
1. Review the BA purpose or direction
Review the BA purpose or direction. The purpose should be applicable for the target BA. Make
the necessary changes if required.
2. Review the BA principles
Refer to the changes in the EA principles if any. Review and make the necessary changes if required.
3. Define the target business functions (BRM)
Review the business areas, LoBs, business functions and sub-business functions. From the tar-
get architecture directions, identify and analyze the areas of improvements such as removal of
duplicated functions, improve customer service and improve business performance. Document the
changes required especially for the business functions and sub-business functions.
254
National Overall Reference Architecture (NORA) – Handbook
Figure ‎11-4: Example of updated business function in target BA
4. Define the target business processes
From the above recommendations for target business functions and sub-business functions,
review the affected processes that require change. Similarly, these processes include duplicated
processes, and processes affected to improve customer service and business performance.
Below is an example of updated business processes.
255
National Overall Reference Architecture (NORA) – Handbook
Figure ‎11-5: Example of updated business processes in target BA
5. Define the target service catalogue
Upon identification of the target business functions, sub-business functions and business
processes, the EA Core and working teams have to identify all the current services affected.
Analyze them and define the target services, i.e. new services, removal of duplicated services,
joint or integrated a few services into one, and improve quality of services.
6. Document the target organization information
Since business processes and business services will change, so does the staff and organization
structure. Review and document the changes required for the target organization chart and
related information.
7. Document and review
Document all the above information according to the agency’s documentation standards. Do
an internal review and updates. It is also advisable to get another party (especially the business
owner and business teams) to carry out a final review.
256
National Overall Reference Architecture (NORA) – Handbook
8. Obtain governance approval
With the completion of the above deliverables, present to the EA Governance Committee. The
Chief Architect or Business Architect should front this presentation. From the comments from
the committee, make the necessary changes to obtain their final approval.
11.4.3 Step 7.3 Build target application architecture
Description about the agency target AA
On completion, the target AA will depict the future application landscape of the government
agency. Since the target AA is the future version of the current AA, both have the same artifacts
or deliverables. The main difference is that the target AA describes about the future scenarios
– i.e. providing solutions to the current issues and challenges such as new application systems.
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of AA
2 AA Principles The architectural principles of AA
3 Application Systems (ARM) The main target application systems for the agency
4 Application Components (ARM) The key target application components for the agency
5 Application Interfaces (ARM) The main target application interfaces for the agency
6 Application Catalogue The target list of applications and their attributes
7 Application Functions The target description about the application functions
8 Application Relationships The target description about the application relation-
ships
9 Application Overview The target overview description of the application systems
Table ‎11-5: Target AA artifact descriptions
257
National Overall Reference Architecture (NORA) – Handbook
Building the agency target AA
Below table summarizes the main activities for building the agency target AA.
S/No Activity Artifact / Deliverable
1 Define the AA purpose or direction Reviewed / updated AA purpose or direction statement
2 Define the AA principles Reviewed / updated AA principles
3 Define the target application systems,
application components and application
interfaces (ARM)
Target application systems, application components and
application interfaces
4 Document the target application overview Target application overview
5 Document the target application catalogue Target application catalogue
6 Document the target application func-
tions and relationships
Target application functions and application relationships
7 Document and review Reviewed draft target AA
8 Obtain governance approval Approved agency target AA
Table ‎11-6: Activities to build target AA
Using the target architecture directions as an input, do the following:
1. Review the AA purpose or direction
Review the AA purpose or direction. The purpose should be applicable for the target AA. Make
the necessary changes if required.
2. Review the AA principles
Refer to the changes in the EA principles if any. Review and make the necessary changes if required.
258
National Overall Reference Architecture (NORA) – Handbook
3. Define the target application systems, application components and
application interfaces (ARM)
Review the current application systems, application components and applications interfaces.
From the target BA, identify affected applications, components and interfaces that are required
to support the future business landscapes.
From the target architecture directions, further explore ways to improve sharing of application
systems and components in the agency. In addition, explore ways to use national or govern-
ment-wide application systems.
Similarly, from the target architecture directions identify how future data usage will affect the
applications. Find solutions to these data usage and exchange and update the target application
systems, components and interfaces.
Below is an example to identify new application systems.
Figure ‎11-6: Example process to identify new application systems & architecture
259
National Overall Reference Architecture (NORA) – Handbook
4. Document the target application overview
Once the target applications, components and interfaces have been identified, document them
into the target application overview. This is a pictorial representation of the target applications
for the government agency.
5. Document the target application catalogue
Similarly, refer to the current application catalogue and update it to reflect the target state.
Preferably, include the target application information such as application type (new, replace or
retire) and the current business processes affected. Thus, the target application catalogue has
to link with the target business processes and target service catalogue.
6. Document the target application functions and relationships
From the list of target application systems, update the application functions and relationships.
Typically, it is good to highlight the changes for the target information. Below is an example of
the updated application function.
Figure ‎11-7: Example of updated application function in target AA
7. Document and review
With the completion of the various application documentation, consolidate them into one
structured document according to the agency documentation standards. Carry out an internal
review to verify all the data and artifacts. It is also recommended that an external or third party
(for example application owners) carry out another review. Based on their feedback, make the
necessary improvements.
260
National Overall Reference Architecture (NORA) – Handbook
8. Obtain governance approval
With the completion of the above deliverables, present to the EA Governance Committee. The
Chief Architect or Business Architect should front this presentation. From the comments from
the committee, make the necessary changes to obtain their final approval.
11.4.4 Step 7.4 Build target data architecture
Description about the agency target DA
On completion, the target DA will depict the future data landscape of the government agency.
Since the target DA is the future version of the current DA, both have the same artifacts or
deliverables. The main difference is that the target DA describes about the future scenarios
– i.e. providing solutions to the current issues and challenges in terms of data usage and data
exchange.
S/No Artifact / Deliverable Description
1 Purpose / Direction The purpose of DA
2 DA Principles The architectural principles of DA
3 Data Model The main target data model for the agency
4 Data Classifications (DRM) The key target data classifications
5 Data Structure (DRM) The main target data structures for the agency
6 Data Exchange (DRM) The list of target data exchanges for the agency
7 Conceptual Data Model The target pictorial high-level description of data
model for the agency
8 Logical Data Model The target logical data models of the agency
9 Data Flow Diagrams The various target pictorial representations of data
flows for the agency
10 Database Portfolio Catalogue The target consolidation of all databases in the agency
11 Data Dictionary The target definitions for common data in the agency
Table ‎11-7: Target DA artifact descriptions
261
National Overall Reference Architecture (NORA) – Handbook
Building the agency target DA
Below table summarizes the main activities for building the agency target DA.
S/No Activity Artifact / Deliverable
1 Review the DA purpose or direction Reviewed / updated DA purpose   or direction
statement
2 Review the DA principles Reviewed / updated DA principles
3 Update data model, data classifications,
data structures and data exchanges (DRM)
Updated target data model, data classifications,
data structures and data exchanges
4 Document the target conceptual and logi-
cal data models
Target conceptual data model and target logical
data model
5 Document the target data flow diagrams Target data flow diagrams
6 Compile the target database portfolio
catalogue
Target database portfolio catalogue
7 Document the target data dictionary Target Data dictionary
8 Document and review Reviewed draft target DA
9 Obtain governance approval Approved agency target DA
Table ‎11-8: Activities to build target DA
Using the target architecture directions as an input, do the following:
1. Review the DA purpose or direction
Review the DA purpose or direction. The purpose should be applicable for the target DA. Make
the necessary changes if required.
2. Review DA principles
Refer to the changes in the EA principles if any. Review and make the necessary changes if required.
262
National Overall Reference Architecture (NORA) – Handbook
3. Update data model, data classifications, data structures and data ex-
changes (DRM)
Review the data model, data classifications, data structures and data exchanges. With the new
target architecture directions, identify artifacts that require update. With the changes in both
the target BA and AA, it is normal that these artifacts collectively require change. The diagram
below illustrates an example to identify and update the artifacts to reflect the future scenarios.
Identify and make the necessary changes to reflect the future state for the data model, data
classifications, data structures and data exchanges.
Figure ‎11-8: Example of identified artifacts for updates in target DA
4. Document target conceptual and logical data models
The target BA and AA will affect the target DA. With the updates done in the above step, there
is a need to review and update the conceptual data model – for example, adding new data enti-
ties and removing of current data entities. It is also necessary to review and update the logical
data models to reflect the additional or changed data attributes and primary or secondary keys.
5. Document the target data flow diagrams
This activity is to review and document the changes to the data flows. With the above changes,
make the necessary updates to the current data flows. Highlight or associate the changes to the
new data models, data entities, and even the new business processes and application systems.
263
National Overall Reference Architecture (NORA) – Handbook
6. Compile the target database portfolio catalogue
A significant change would be to the database portfolio catalogue. Review the current cata-
logue and compile the target catalogue. The diagram below is an example of the changes
required to various databases.
Figure ‎11-9: Example updated database diagram
7. Document the target data dictionary
Finally, review the current data dictionary and update the documentation to reflect the target
data dictionary. It is necessary to describe the difference in the data elements and definitions
from current to target.
8. Document and review
Upon completion of the above deliverables, document all the relevant information into a struc-
tured target DA document base on the government agency’s documentation standards. Carry
out an internal review and appropriate updates. It is also a good practice to get an external
party to review the DA document such as DBAs and business owners.
264
National Overall Reference Architecture (NORA) – Handbook
9. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to the
EA Governance Committee. The Chief Architect or Data Architect should front this presenta-
tion. From the comments from the committee, make the necessary changes to obtain their
final approval.
11.4.5 Step 7.5 Build target technology architecture
Description about the agency target TA
On completion, the target TA will depict the future infrastructure landscape of the government
agency. Since the target TA is the future version of the current TA, both have the same artifacts
or deliverables. The main difference is that the target TA describes about the future scenarios –
i.e. providing technology solutions to the current issues and challenges.
S/
No
Artifact /
Deliverable
Description
1 Purpose / Direction The purpose of TA
2 TRM Principles The architectural principles of TA
3 Service Area (TRM) The highest level technology service area
4 Service Category (TRM) The technology service category within a service area
5 Service Standard (TRM) The target list of technology service standards
6 Infrastructure Overview The target high-level representation of IT landscape in the government
agency (normally in diagrammatic form)
7 Infrastructure Description The target descriptions of the main infrastructure technologies for future
8 Hardware Catalogue The list of hardware (no change; only when actual implementation)
9 Software Catalogue The list of software (no change; only when actual implementation)
Table ‎11-9: Target TA artifact descriptions
265
National Overall Reference Architecture (NORA) – Handbook
Building the agency target TA
Table 11-10 summarizes the main activities for building the agency target TA.
S/
No
Activity Artifact / Deliverable
1 Review the TA purpose or direction Reviewed / updated TA purpose or di-
rection statement
2 Review the TA principles Reviewed / updated TA principles
3 Review the service areas and service cat-
egories (TRM)
Reviewed service categories within ser-
vice areas for the agency
4 Define the target service standards Target service standards within each
service category relevant for agency
5 Describe the target infrastructure over-
view
High-level representation of target IT
landscape in agency
6 Update the target infrastructure descrip-
tions
Target infrastructure technology de-
scriptions and diagrams
7 Document and review Reviewed draft target TA
8 Obtain governance approval Approved agency target TA
Table ‎11-10: Activities to build target TA
Using the target architecture directions as an input, do the following:
1. Define the TA purpose or direction
Review the TA purpose or direction. The purpose should be applicable for the target TA. Make
the necessary changes if required.
2. Review TA principles
Refer to the changes in the EA principles if any. Review and make the necessary changes if
required.
266
National Overall Reference Architecture (NORA) – Handbook
3. Review the service areas and service categories (TRM)
Review the service areas and categories to ensure that these are correct and relevant. From
the target architecture directions, review if impact on the service areas and service categories.
Typically, there will be some changes required. The diagram below shows an example of how
the technology directions will affect the technology contents or service categories. Make the
relevant changes to reflect the future state.
Figure ‎11-10: Example of direction setting for in TA
4. Define the target service standards (TRM)
Once the service areas and service categories have been updated, the EA Core and working
teams have to define the target service standards that may include new standards or replacement
of current standards. It is also necessary to define obsolete standards.
5. Describe the target infrastructure overview
Compare the target service categories and standards with the current infrastructure overview
diagram. Simple analysis would allow the team to identify transformation or improvement areas
as shown in the example diagram below. Identify them and update the diagram into the target
infrastructure overview.
267
National Overall Reference Architecture (NORA) – Handbook
Figure ‎11-11: Example of updated infrastructure overview in target TA
6. Update the target infrastructure descriptions
Review the current infrastructure descriptions. From the areas of improvements identified above,
update the appropriate infrastructure descriptions. Note that in most cases the descriptions do
not change much, but rather the corresponding technology diagrams that require updates.
7. Document and review
After updating all the definitions and standards, document the relevant information into a
structured information base on the agency’s documentation standards. Do an internal review
and updates. It is also advisable to get another party (especially the technology and operations
teams) to carry out a final review.
8. Obtain governance approval
With the completion of the deliverables with the other above related contents, present to
the EA Governance Committee. The Chief Architect or Technology Architect should front this
presentation. From the comments from the committee, make the necessary changes to obtain
their final approval.
268
National Overall Reference Architecture (NORA) – Handbook
Stage8–Develop
TransitionPlan
269
National Overall Reference Architecture (NORA) – Handbook
12. Stage 8 – Develop
	 Transition Plan
12.1 Stage summary
With the completion of the various target architectures in the previous stage, it is now important
to plan and manage the transition required from the current landscapes to the desired target
landscapes. There is a big gap between current and target architectures. If these are not managed
through the transition plan, it is typical that the target architecture would not be realized.
The transition plan is about defining and prioritizing intermediate activities, systems and projects
in order to implement that future state of the target architectures. The major focus of this stage
is to develop a detailed transition plan consisting of projects or activities, required resources,
timeline and budget. Techniques such as ABC Analysis, Priority Analysis, ROI Analysis can be
utilized in this stage.
12.2 Stage purpose
The purpose of this stage to manage the transition between the current states to the target
state. The expected outcomes or deliverables of this stage is:
1. Transition Plan.
12.3 Stage initiation
With the completion of the previous stage, the EA Core and working teams have to ensure that
the following deliverables are in place:
1.	Target Business Architecture
2.	Target Application Architecture
3.	Target Data Architecture
4.	Target Technology Architecture.
270
National Overall Reference Architecture (NORA) – Handbook
Depending on the EA scope and development strategy, the government agency has to ensure
that the corresponding target architectures are completed. If the government agency intends to
build all architectures, then it needs the four above target architectures. However, if the government
agency is doing a specific EA scope such as data and technology consolidation, then it needs to
have at least the target data and technology architectures in place.
12.4 Key steps in stage 8
Below table list the key activities and expected deliverables for stage 7.
Stage /
Step No
Description Deliverable
8 Develop Transition Plan Transition Plan
8.1 Define transition projects Transition project list
8.2 Prioritize transition  projects Prioritized transition project list
8.3 Create transition roadmap Transition roadmap
8.4 Analyze and document required
resources and outcomes
Transition resource plan
8.5 Obtaining governance approval Approved transition roadmap and resource plan
Table ‎12-1: Stage 8 steps
12.4.1 Step 8.1 Define transition projects
This activity is about defining and prioritizing transition projects.
S/No Activity Description
1. Define Ideas for Improvement Improvement ideas are defined by classifying them into
business/application sectors or with agency’s core busi-
ness functions
2. Define Transition Projects Transition projects are defined by listing up ideas for im-
provement, a target architecture, and each architecture
area.
List transition projects from the current and target
architecture gap analysis and complete the project
list by adjusting and organizing them while consid-
ering priority, sequence, etc.
Table ‎12-2: Activities to define transition projects
271
National Overall Reference Architecture (NORA) – Handbook
Figure ‎12-1: Example selection method for transition plan
Figure ‎12-2: Example of transition project
12.4.2 Step 8.2 Prioritize transition projects
After defining all the required transition projects, it is necessary to prioritize them. The table
below lists the key activities to prioritize these projects.
272
National Overall Reference Architecture (NORA) – Handbook
S/
No
Activity Description
1. Define Project Value •	 Define their values according to relationships be-
tween projects, such as the project’s characteristics,
importance, effectiveness etc.
2. Define Priorities •	 Prioritize them based on results of their validity
and risk assessment with considering relationships
between projects
3. Define Stages for Project •	 Based on projects and their priority assessment,
define transition projects by stage
Table ‎12-3: Activities to prioritize transition projects
Figure ‎12-3: Example prioritization principles
273
National Overall Reference Architecture (NORA) – Handbook
Figure ‎12-4: Example priority assessment structure
Figure ‎12-5: Example priority assessment
274
National Overall Reference Architecture (NORA) – Handbook
Figure ‎12-6: Example transition projects by stages
12.4.3 Step 8.3 Create transition roadmap
Make EA transition roadmap according to the project’s priority, interface, and pre / post rela-
tionships, and develop a detailed schedule by each project.
S/
No
Activity Description
1. Write project purposes in each stage Set an overall planning phase or stage (3 - 5 years)
and define desired objectives by year
2. Write a transition project roadmap in
each stage
List up projects of higher priority in each stage
Write it by mapping each transition project with
each stage
3. Write a detailed schedule by each
transition project
Write a detail schedules for each project and its
sub-projects
Table ‎12-4: Activities to create transition roadmap
275
National Overall Reference Architecture (NORA) – Handbook
Figure ‎12-7: Example of goal setting for each stage
Figure ‎12-8: Example detailed schedule by each stage
276
National Overall Reference Architecture (NORA) – Handbook
12.4.5 Step 8.4 Analyze and document required resources and outcomes
Estimate the required resources for all projects and analyze expected outcomes according to
the EA project plan in each stage.
S/
No
Activity Description
1. Define a method of estimat-
ing required resources
Define type of required resources and an estima-
tion method according to the type in order to de-
duct required resources by each classification
2. Estimate required resources
by each transition project
Estimate required resources by each transition proj-
ect according to their type
3. Estimate required resources
by year
Estimate required resources by year according to EA
Transition roadmap in each stage
4. Define expected outcomes Write a detail schedules for each project and its
sub-projects
Table ‎12-5: Activities for estimating resources and outcomes
Figure ‎12-9: Example resource estimation procedure
277
National Overall Reference Architecture (NORA) – Handbook
Figure ‎12-10: Example required resource classification
Figure ‎12-11: Example resource estimation
Figure ‎12-12: Example resource requirements by stage
278
National Overall Reference Architecture (NORA) – Handbook
Figure ‎12-13: Example expected outcome
Some general considerations:
•	 Although subject to the agency and their environment, it is normal to set a transition period
to target architecture as 3 - 5 years. In this case, it is a good way to make “transition archi-
tecture”, middle-stage of target architecture that can play role of a milestone to transition.
•	 Because of a sudden change of business environment, technology development, etc. a transition
plan as well as developed target architecture can be modified. Therefore, both target architecture
and transition plan should be managed by EA.
•	 Whether a transition plan is succeed or not depends on concreteness and realistic possibility
of the plan. In other words, we should consider ‘is it reasonable when it comes to expense/
effectiveness analysis?’, ‘does it fully reflect users’ requirements on target architecture?’, ‘do
agency’s stakeholders fully participate in developing transition plans and fully understand
the contents?’ etc.
•	 The transition to target environment does not happen rapidly, but is perform gradually by
each architecture area or transition stage according to EA transition plan. Because of this, it
takes much time to completely transit to target environment, and a transition process and
279
National Overall Reference Architecture (NORA) – Handbook
transition elements are very complicated. Therefore, for successful transition, we should
minimize risks against changes, protect investment, organize plans for secure transition,
and reflect them on a transition plan.
12.4.5 Step 8.5 Obtain governance approval
With the completion of the deliverables with the other above related contents, present to the
EA Governance Committee. The Chief Architect should front this presentation. From the comments
from the committee, make the necessary changes to obtain their final approval.
280
National Overall Reference Architecture (NORA) – Handbook
Stage9–Develop
ManagementPlan
281
National Overall Reference Architecture (NORA) – Handbook
13. Stage 9 – Develop
Management Plan
13.1 Stage summary
This stage is about developing the EA usage and management plans so that EA processes and val-
ues become an integral part of the agency standard operating procedures. To ensure continued
EA value delivery to the government agency, it is necessary and important to incorporate EA
management plans into the government agency.
13.2 Stage purpose
The purpose of this stage is to analyze and document the plan in ensuring the EA deliverables
are accepted and use by the different stakeholders in the government agency. The expected
outcomes or deliverables of this stage are:
1.	EA usage plan
2.	EA management plan
13.3 Stage initiation
With the completion of the previous stage, the EA Core and working teams have to ensure that
the following deliverables are in place:
1.	Transition Roadmap
2.	Transition Resource Plan.
This stage is also a follow up on important policies or direction statements previously defined un-
der Continuous Governance section – on particular, on EA usage and EA management directions.
282
National Overall Reference Architecture (NORA) – Handbook
13.4 Key steps in stage 9
The table below lists the key activities and expected deliverables for stage 9.
Stage /
Step No
Description Deliverable
9 Develop Management Plan EA Usage and Management Plans
9.1 Develop EA usage plan EA usage plan
9.2 Develop EA management plan EA management plan
9.3 Obtaining Governance Approval Approved EA usage and management plans
Table ‎13-1: Stage 9 steps
Management and Governance
Under the Continuous Governance section, the EA Governance Committee has set up
clear directions on the EA usage and management plans. This stage will focus on the de-
.velopment of these plans
13.4.1 Step 9.1 Develop EA usage plan
It is an activity to specify EA usage ways by defining its purposes and scope through analyzing
agency’s environment & possible users. The following are the activities to develop the EA usage
plan.
1. Define Usage Purposes & Scope
Based on EA usage policy or direction statements defined under governance section, the EA
Core and working teams have to define the EA usage purposes & scope.
283
National Overall Reference Architecture (NORA) – Handbook
S/
No
Activity Description
1.a Define usage purposes •	 Based on above Identifying, define usage purposes as
to make them a common decision-making standard
for achieving EA implementation purposes & expected
outcomes
•	 Above purposes are comprehensive. So, they also can be
defined specifically, like core use purposes, supplementary
use purposes, etc.
1.b Define usage scope •	 Based on above Identifying, define EA usage scope by
grouping shared elements
•	 EA usage scope of agencies doing EA demonstration
project is defined as a IT life cycle, such as IT planning,
IT project performing, IT operation, IT assessment, etc.
Table ‎13-2: Activities to define EA usage purpose & scope
Figure ‎13-1: Example for EA usage purposes
284
National Overall Reference Architecture (NORA) – Handbook
Figure ‎13-2: Example for EA usage scope
2. Usage Plan Development
In order that the agency performs practical IT projects using architecture information, they need
guidelines that describe which each EA usage scenario can use the appropriate architecture infor-
mation. Define EA usage process by each scope, in order that the EA supports common decision-
makings while performing practical IT projects.
285
National Overall Reference Architecture (NORA) – Handbook
S/
No
Activity Description
2.a Define Usage
tasks
•	 Identify and define EA usage tasks based on its objectives and
scope.
2.b Define possible
users
•	 Define directly/indirectly related-stakeholders with EA projects
•	 Among stakeholders, Identify future EA users through holding
internal meetings
•	 Define EA user groups by classifying them with their roles, and
define each group’s roles and responsibilities
•	 In addition, define roles related to using architecture information
2.c Define Usage
scenario
•	 Write a business flow based on business activities and related
organizations that are defined in usage tasks
•	 Identify and define business activities which are required to
use architecture information by each usage task
•	 Define which architecture information can be used for doing
each business activity. In other words, we can define the
name and item of specific artifact.
2.d Develop Usage
Guideline
•	 Define a list for using EA information, and make a guideline
•	 Based on usage scenario, write a guideline for fully using EA
by each task.
Table ‎13-3: Activities to define usage plan development
286
National Overall Reference Architecture (NORA) – Handbook
Figure ‎13-3: Example for EA usage tasks
User Main role Related organization
Decision-Maker -	A final decision-maker about business
innovation, IT project promotion, and IT
project policies
The official in charge of IT
IT Promotion Committee
Architecture Review Commit-
tee
IT Investment Review Board
IT Planning De-
partment
-	Making mid and long term IT plans
-	Budgeting on unit information system
development/ operation and assessing the
results
IT Planning Team
Budget Planning Team
Architecture Man-
agement Depart-
ment
-	Managing the information such as EA stan-
dard, etc.
Architecture Management
Team Architecture Group
User/ Business
Department
-	As being in charge of agency’s businesses,
they also offer requirements from users, etc.
International Affairs Division
Public Service Center
287
National Overall Reference Architecture (NORA) – Handbook
User Main role Related organization
IT Project
Department
-	They are in charge of unit system develop-
ment, from project planning to system
development/ operation
System Development Group
System Maintenance Group
System
Development
Department
-	Most of them are external agencies which
are in charge of system development
System Development Team
System Operation
Department
-	Most of them are external agencies which
are in charge of system operation
System Operation Team
Table ‎13-4: Example for EA users
Figure ‎13-5: Example for the relationship between EA tasks and artifacts
3. Obtaining Governance Approval
With the completion of the deliverables with the other above related contents, present to the
EA Governance Committee. The Chief Architect should front this presentation. From the com-
ments from the committee, make the necessary changes to obtain their final approval.
288
National Overall Reference Architecture (NORA) – Handbook
13.4.2 Step 9.2 Develop EA management plan
The value of EA is for it to be utilized when making decisions with using pertinent information
and linkages. It is important to maintain accuracy and consistency of EA information; hence, EA
management plan helps to maintain EA continuously by not only setting EA directions but also
making EA management structure and EA management process. The following are the simple
activities to develop the EA management plan.
1. Define EA Management Purposes & Scope
Based on the EA management policy defined under governance, define EA management pur-
poses & scopes, and develop EA management principles.
S/
No
Activity Description
1.a Define EA
management
purposes
•	 Define EA management purpose which matches agency’s architecture
purposes & directions from best practices
1.b Define EA
management
scope
•	 Define EA management scope with considering EA project purposes,
scope, principles, and purposes for EA use
•	 Identify maintenance-needed-elements with referring to identified
management scope
•	 EA management targets are organizations, human resources, systems,
application, architecture’s artifacts, etc.
•	 Define the organization’s EA management scope with referring to above
identified management scope and target elements
•	 Check if developed EA management scope has omitted items by refer-
ring to other agencies’ EA management scope and targets
•	 Confirmed EA management scope in here includes defining an
organization, management process, management support system, etc.
1.c Define EA
management
principles
•	 Identify key management points for defining management principles
(organization, competency, operation, methods for review, system, etc.
•	 Define management principles by each management point which EA
management plan should follow for achieving management purposes
Table ‎13-5: Activities of EA management purposes & scope
289
National Overall Reference Architecture (NORA) – Handbook
Figure ‎13-6: Example of EA management plan
Figure ‎13-7: Example of EA management scope
290
National Overall Reference Architecture (NORA) – Handbook
Figure ‎13-8: Example for EA management plan process
Figure ‎13-9: Example for EA management plan principles
291
National Overall Reference Architecture (NORA) – Handbook
2. Develop EA Management Organization
Define EA management organization’s structure & roles for maintaining EA, EA management
process for following architecture principles and attaining architecture goals, and EA manage-
ment support systems for supporting it.
S/
No
Activities Description
2.a EA management
organization definition
•	 Figure out management tasks and their required functions
by checking management scope and targets
•	 Based on management tasks and functions, figure out
required organizations that can perform the tasks
•	 If there are no related organizations that can perform the
tasks, we can create a new organization
•	 Based on the tasks and organizations, we can define their
organizational structure by building up a decision-making
structure for performing the tasks
2.b EA management
organization’s roles
definition
•	 Analyze stakeholders of a management organizational
structure, and identify their required roles
•	 Define their roles that define responsibilities and authori-
zation by the management organizational structure’s each
organization
•	 Based on roles, redefine the organizational structure, and
make an institutional change plan
Table ‎13-6: Activities to develop EA management organization
292
National Overall Reference Architecture (NORA) – Handbook
Figure ‎13-10: Example for EA roles for large organization
Figure ‎13-11: Example for architect tasks
293
National Overall Reference Architecture (NORA) – Handbook
3. Define EA Management Process
In EA governance section, there are five aspects such as change, program, performance,
capability, and policy management. In this section, it will provide more detail processes of
EA management.
S/
No
Activity Description
3.a Define EA planning
process
•	 Define EA planning process by developing EA and reflecting
any improvements of EA.
3.b Define EA change
management process
•	 Define EA change management process of maintaining and
updating EA information
•	 Define EA change management process which includes
overall process from requesting, processing, to releasing
changes
•	 Architecture update: define a process of regular
     planning and target architecture designing for architecture
     improvements
•	 Architecture change: define a process of reviewing and
authorizing change requests
•	 Architecture diffusion: a practical way of performing
can be different according to an architecture diffusion
target and channel. We can develop a process of planning,
execution, and feedback for architecture diffusion
•	 Architecture compliance review: develop a process
of checking if it complies with ‘current architecture’ in IT
system development project
•	 Design for exceptions: develop a process of designing
alternatives to the architecture, with which we can review
validity of exceptions and applying them
•	 Architecture-based IT system design: providing an
outline of IT systems based on architecture and target
architecture in order to support IT system development
3.c Define EA use support
process
•	 Define EA support process for smoothly sharing and using
EA information
294
National Overall Reference Architecture (NORA) – Handbook
3.e Define a system
management process
•	 Define a process of managing and operating management
systems used for maintaining EA information
•	 Based on management system’s operating organizations,
define a system operation process, such as system change
process, system back-up process, etc.
•	 Define a process with referring to a guideline for operating
IT systems
3.f Define an
assessment process
•	 Define a process of assessing EA information’s use & man-
agement
•	 The agency can assess outcomes by themselves through de-
veloping their own performance indicators with reference to
performance reference model in EA development phase
•	 Agency can assess agency’s EA maturity level with reference
to EA maturity model that was made by Yesser (refer
Annex E)
Table ‎13-7: Activities to define EA management process
Figure ‎13-12: Example for EA update process
295
National Overall Reference Architecture (NORA) – Handbook
Figure ‎13-13: Example for EA change process
Figure ‎13-14: Example for EA diffusion process
296
National Overall Reference Architecture (NORA) – Handbook
Figure ‎13-15: Example for EA compliance review
Figure ‎13-16: Example for EA design exception process
297
National Overall Reference Architecture (NORA) – Handbook
Figure ‎13-17: Example for EA system design
4. Develop EA Management System
Develop EA management system for continuously maintaining and using EA artifacts and EA-
related information.
S/No Activities Description
4.a Define
requirements
•	 Checking and organizing basic functions of management systems
•	 Define a function of using EA artifacts information in terms of various
tasks
•	 Define a function of continuously maintaining EA artifacts information
•	 Define a function of linking with management tools which are used for
creating artifacts
•	 Define a function of linking internal systemsㅡlinking assets
management system, performance management system, and
business management system, which are operated by the
agency, themselves, with EA information
•	 Define linking functions required to offer agency’s EA artifacts in-
formation to national EA management system
4.b Build up
a system
•	 After defining system requirements, a system can be built based on
them with using system development methodology. Development
methodology can be referred to for system buildup.
Table ‎13-8: Activities to define EA management system
298
National Overall Reference Architecture (NORA) – Handbook
See below table of example requirements.
Function Description
Framework Management Managing a framework, a standard for managing agency’s
EA systematically
Meta-model Management Registering and managing standardized Meta-model to
register artifacts
Reference Model Management Registering and managing BRM, ARM, DRM, TRM, and PRM
Artifact Management Registering and managing EA artifacts
Architecture Analysis Analyzing architecture artifacts with various types
System Management Managing system, such as user management, authoriza-
tion management, etc.
Table ‎13-9: Example for EA management system’s functions
5. Develop EA Management Guideline
EA management guideline helps to update EA on the current status against changes of projects
or IT systems, and is composed of management principles, organizations, and process.
6. Obtaining Governance Approval
With the completion of the deliverables with the other above related contents, present to the EA
Governance Committee. The Chief Architect should front this presentation. From the comments
from the committee, make the necessary changes to obtain their final approval.
299
National Overall Reference Architecture (NORA) – Handbook
Stage10–Execute
andMaintain
300
National Overall Reference Architecture (NORA) – Handbook
14. Stage 10 – Execute and Maintain
14.1 Stage Summary
This is the last stage where a government agency executes and maintains its EA. Having cov-
ered many stages in the EA journey, this last stage concerns with taking actions to make the
government agency’s EA into a reality.
14.2 Stage Purpose
The purpose of this stage is to finally implement the EA artifacts that were documented in the
previous stages. The following are the expected outcomes of this stage:
1.	Promote or market the government agency’s EA so that government employees are aware
of the usefulness of EA
2.	Train some employees on the using and maintaining the various information related to EA
3.	Execute or implement the EA including the management of the transition activities
14.3 Stage Initiation
With the completion of the previous stages, the EA Core Team and working teams have to en-
sure that the following deliverables, in addition to the target architectures, are in place:
1.	EA Management Plan
2.	EA Usage Plan
3.	EA Transition Plan
With all the above plans, the EA Core Team and working teams can start the execution phase.
301
National Overall Reference Architecture (NORA) – Handbook
14.4 Key Steps in Stage 10
The last stage is the final challenge for the EA Core team and working team members to materialize
their previous efforts. The key steps in Stage 10 are shown in Table 14-1.
Stage /
Step No
Description Deliverable
10 Execute and Maintain
10.1 Implement the EA Usage & Management Plan Project/Program Management
Deliverables
10.2 Implement the EA Transition Roadmap Project/Program Management
Deliverables
Table ‎14-1: Stage 10 steps
14.4.1 Step 10.1 Implement the EA usage & management plan
Another challenge for the EA Core team and working teams is the actual implementation of
the EA usage & management plan that was prepared in the previous phase. It is one thing to
prepare the plan, but it requires effort and coordination to actually implement the EA usage &
management Plan. This is where all the organization, systems, resources and the governance/
management processes are implemented in a coordinated manner.
The EA Core team has to ensure that the EA usage & management plan are executed according
to the details in the plan. To some extent, some of the areas in the plan have been covered or
described in the steps above such as EA governance / management including the change man-
agement aspect. A few important things to note are:
302
National Overall Reference Architecture (NORA) – Handbook
1. Institutionalization the usage & management plan
It’s required to make EA usage & management guideline mandatory in order to continuously
manage and use EA and make an internal notice of whether the guideline is followed to all
organizations.
Figure ‎14-1: Example for EA usage guideline
303
National Overall Reference Architecture (NORA) – Handbook
Table ‎14-2: Example for EA management guideline
2. EA usage and management plan execution
We can use EA at work based on the EA usage and management guideline. All EA information
and related artifacts should be regularly or instantly updated as change management process
after that we can execute EA plans smoothly. In case EA system has been developed, we can
derive and use EA information from it based on EA use scenario.
3. EA usage and management plan supervision
EA team’s manager can supervise the status of EA operation and usage according to EA
guidelines. Continuously monitor whether EA management processes and EA usage sce-
narios are being well obeyed. In case EA system has been developed, we can figure out EA
utilization status by using statistics, etc. from the EA system.
304
National Overall Reference Architecture (NORA) – Handbook
4. EA usage and management plan assessment
Define assessment elements to evaluate EA usage and management plans and regularly (once
a year) conduct assessments by investigating and interviewing stakeholders.
Elements Key contents
Compliance
1
Have all the usage & management tasks specified in EA guidelines been
applied at work?
Check them by making a list of usage & management tasks in EA
guidelines
T/F
2
Has architecture information been updated according to EA usage &
management process?
Check them by making a list of architecture information to be updated
T/F
3
Does the person in charge use/follow EA usage/management procedures
regarding to their tasks?
Check them by making a list of usage & management tasks
T/F
Compatibility
1
Is EA usage & management process correct?
Check them by making a list of EA usage & management processes
T/F
2
Is architecture information updated according to a usage & management
process correct?
Check them by making a list of architecture information by each EA us-
age & management task
T/F
Convenience
1
Isn’t EA usage & management process complicated?
Check them by making a list of EA usage & management tasks
T/F
2
Does it take too much time to process EA usage & management tasks?
Measure time of processing each EA usage & management tasks
T/F
3
Is it easy to update EA information according to each usage &
management tasks?
Can use 1-5 point scale
4
What’s satisfaction level caused by utilizing & managing EA?
Can use 1-5 point scale
Table ‎14-3: Example for EA usage & management plan assessment
305
National Overall Reference Architecture (NORA) – Handbook
5. EA usage and management plan improvement
Based on the results of EA usage & management plan assessment, its improvement directions
can be defined and EA usage & management plan can be supplemented and enhanced.
14.4.2 Step 10.2 Implement the EA transition roadmap
The transition of EA from the current state to the eventual target is a challenging task, but with
great satisfaction when it is completed successfully. In the implementation of the EA Transition
Roadmap, the EA Core team and working teams have to act as coordinators (between projects
and divisions) and advisors (on what the project owners should do and when).
While the previous step tackles all the management / governance areas, this step focuses on
the basic steps to implement the transition projects and activities. With the EA Transition Road-
map prepared in the previous phase, the implementation of this roadmap has three main activi-
ties as follows:
1. Review and update the EA Transition Roadmap
Since the EA Transition Roadmap was prepared and approved, there are many activities such as
conducting awareness sessions, presentation to the stakeholders and discussions on new ini-
tiatives. Over time, some of these discussions could spin off other projects or affect the original
schedule and priority of the projects in the transition roadmap. It is necessary, therefore, to review
and update the EA Transition Roadmap from various feedback, suggestions and new directives
from top management. The following are recommended activities:
a.	Add, update or remove the projects identified; if need be, re-prioritized the whole list of
projects
b.	For each project, identify and confirm the project owner. In addition, check the resources
and schedules are reasonable. If not, update the resources required and time needed to
complete the projects
c.	 Update the Transition Roadmap. If major updates were done, get approval from the EA Gov-
ernance Committee
d.	Also update the Program Management Plan correspondingly.
306
National Overall Reference Architecture (NORA) – Handbook
2.Assign projects to Project Owners
With the approved updated EA Transition Roadmap, the EA Core team has to inform and assign
the projects to the respective project owners. It is recommended that each project carry out
the following:
a.	Formation of Project Team (Project Owner, Project Manager and Project Members)
b.	Briefing to the Project Team by the EA Core Team on expected deliverables and resources
provided
c.	 Formalize communication channel for Project Team to update and report progress to the EA
Program Manager. Key Performance Indicators (PKIs) have to be established so that the EA
Transition Roadmap can be tracked and the overall progress can be updated to the EA Gov-
ernance Committee.
3.Track and report progress of transition
Last but not the least, all the projects and major activities in the EA Transition Roadmap have
to be tracked. For consistent, good program management and tracking of the various projects,
the following are recommended:
a.	Centralize all reporting into a management dashboard if possible
b.	Determine flags or indicators to measure project progress – i.e. % completion and green,
amber or red flags
c.	 Occasionally, review the EA program management and link to the relevant EA governance /
management areas in previous step. There may also be a need to update the EA artifacts as
the various projects progress (see next step).
307
National Overall Reference Architecture (NORA) – Handbook
Annex A: NORA Summary of
Deliverables by Stages
The following tables summarize the deliverables within the different stages of NORA.
STAGE 1: Develop EA Project Strategy
Item Description
Summary This stage describes the key activities to research, plan and obtain approval
to embark on the EA project. Each government agency has to obtain its
project funding and to either develop its EA internally or outsource.
Purpose Lay the foundation of a government agency’s EA implementation journey
with clear directions and commitments.
Initiation Yesser will communicate with the e-Transformation Committee in each
government agency to initiate the agency EA implementation. Govern-
ment agencies can also request and discuss with Yesser to initiate their EA
program.
Table ‎14-4: Stage 1 summary
308
National Overall Reference Architecture (NORA) – Handbook
Stage /
Step
No
Description Deliverable
1 Develop EA Project Strategy Government Agency’s EA Project Strategy
1.1 Analyze EA trends and case studies (both
international and local agencies; also
across same line of business /
segment)
Document relevant EA trends and case studies
relating to the government agency
1.2 Provide EA awareness to government
agency’s business and IT leaders
(Government agencies can invite Yesser
to brief on NEA)
Understand the importance of EA
1.3 Assess government agency’s
e-transformation maturity (Via Qiyas)
and its alignment of IT to the government
business
Submit and present the assessment report to the
e-Transformation Committee or equivalent. The
assessment shall describe the agency’s:
1.	Maturity of its e-transformation
2.	Effectiveness of its business functions
3.	Maturity on IT adoption
4.	 Organization capability on business productivity
and use of IT.
1.4 Document government agency’s EA
project strategy
Draft Government Agency’s EA Project Strategy
1.5 Present and obtain approval for the EA
project strategy
Approved Government Agency’s EA Project
Strategy by its e-Transformation Committee or
equivalent
Table ‎14-5: Stage 1 steps
309
National Overall Reference Architecture (NORA) – Handbook
STAGE 2: Develop EA Project Plan
Item Description
Summary Having established an approved EA Project Strategy, the government agency
has to carry out the detailed plan for the EA project. This stage describes the
key activities involved in developing and obtaining approval for the EA project.
Purpose The government agency has to structure and form appropriate EA team(s)
and develop the detailed EA project plan.
Initiation This stage begins with the endorsement or approval of the EA Project Strategy
in Stage 1.
Table ‎14-6: Stage 2 summary
Stage /
Step No
Description Deliverable
2 Develop EA Project Plan Government Agency’s EA Project Plan
2.1 Upon approval of the Project Strategy (Step 1.4),
propose and set up the various EA committees
and teams such as EA Governance Committee,
EA Working Team, Business-Domain Working
Team and the IT Working Team.
Approved EA committees and working
teams by the e-Transformation Committee
or equivalent
2.2 Finalize the EA development approach such as
scope, budget, schedule, and including outsourc-
ing or insourcing of the Government Agency’s EA
implementation. Also include the adoption of EA
culture into all aspects of business and IT plan-
ning and reviews
Approved EA development approach by e-
transformation committee or equivalent
2.3 Upon approval of Steps 2.1 & 2.2, the EA working
team will document the detailed EA Project Plan
Draft EA project plan
2.4 Present and obtain approval for the EA project
plan
Approved EA project plan by the EA Gover-
nance Committee
Table ‎14-7: Stage 2 steps
310
National Overall Reference Architecture (NORA) – Handbook
Continuous Governance
Item Description
Summary As EA is a massive and long-term project, there are bound to be many challenges and
issues. It is vital, therefore, that the EA governance work is also address to ensure the suc-
cess of the project.
Purpose The previous stage has defined he roles and responsibilities of the EA Governance Committee.
Hence, the purpose of the EA governance is very clear, i.e. to steer and direct the EA project
to successfully meet the government agency’s vision, mission and strategic goals.
Initiation The government agency’s e-Transformation Committee started the governance by reviewing
and approving the EA Project Strategy in Stage 1. The EA governance officially started with
the formation of the EA Governance Committee in Stage 2. Note that the EA governance is
a continuous activity affecting all stages.
Table ‎14-8: Continuous governance summary
Stage /
Step No
Description Deliverable
All Continuous Governance Success of Government Agency’s EA Project
1. Track and monitor the key activities and deliverables
of the EA. Highlight to EA Governance Committee on
potential delays, changes in scope, and lack of re-
sources
Program management of Government Agency’s
EA implementation
2. Manage the introduction and changes to the vari-
ous activities in the EA. In particular, carry out ac-
tivities on EA awareness and promotion
Change management especially on  awareness
and promotion of Government Agency’s EA
3. Manage the capability requirements for the EA
implementation that includes training, changes to
job scope, and review of division / department or-
ganizational structures
Capability management on the progression on
the government agency’s capabilities to carry
out the EA plans
4. Manage the policies and regulations required to
implement the different factors or activities of the
EA in the government agency
Policy management on the policies and regu-
lations relating to the EA execution
5. Manage the performance outcomes of the EA in
the government agency
Performance management on the metrics, KPIs
and outcomes of the EA
Table ‎14-9: Continuous governance steps
311
National Overall Reference Architecture (NORA) – Handbook
STAGE 3: Analyze Current State
Item Description
Summary With the approved EA project plan in place, the EA Core and working teams
can start the actual work by analyzing the current state of the government
agency. This stage describes the key activities in reviewing and analyzing
the different aspects of the current state of the government agency.
Purpose The government agency has to carry out requirements study and detailed
analysis of the current state in terms of both business and IT.
Initiation This stage begins with the endorsement or approval of the EA Project Plan
from Stage 2.
Table ‎14-10: Stage 3 summary
Stage /
Step No
Description Deliverable
3 Analyze Current Stage a.	EA Requirements
b.	EA Environment Analysis Reports
	 (Current Business Landscape and
	 Current IT Landscape)
c.	SWOT Analysis Report
3.1 Gather and document EA require-
ments from various stakeholders such
as e-Transformation Committee, EA
Governance Committee, main business
functions’ stakeholders, and EA working
teams
Government Agency’s EA requirements re-
viewed by EA Governance Committee
3.2 Gather and analyze Government
Agency’s internal environment such as
organizational capability to plan and
execute e-transformation plan, busi-
ness plan and IT plan
Government Agency’s EA environment
analysis report reviewed by EA Gover-
nance Committee
312
National Overall Reference Architecture (NORA) – Handbook
3.3 Gather and analyze Government Agen-
cy’s external environment such as gener-
al trends in EA, United Nations or similar
e-Government rankings including recom-
mendations, prioritized national projects
and new government policies
Government Agency’s EA environment
analysis report reviewed by EA Gover-
nance Committee
3.4 Present to the EA Governance
Committee
EA Governance Committee is informed
about the detailed current state of the
government agency
Table ‎14-11: Stage 3 steps
STAGE 4: Develop EA Framework
Item Description
Summary This is the stage where a government agency starts to develop its EA.
In this stage, the government agency constructs the main pillars such
as EA vision & mission, architecture goals & principles, EA Framework,
taxonomy, and other related standards that is fundamental to its EA jour-
ney. The government agency should focus on building quality EA framework and
other relevant processes.
Purpose The previous stage gave the EA requirements and environment analysis reports
so that the EA team knows what the government agency’s EA has to address.
The purpose of stage 4 is to architect important EA fundamentals that will steer
and guide the EA development in subsequent stages.
Initiation This stage begins with the completed EA requirements, environment analysis
reports (both current business and current IT landscapes) and the SWOT analysis
report from Stage 3. Note that the EA Governance Committee may also provide
additional strategic requirements at the end of Stage 3.
Table ‎14-12: Stage 4 summary
313
National Overall Reference Architecture (NORA) – Handbook
Stage
/ Step
No
Description Deliverable
4 Develop EA Framework Government Agency’s EA Mission,
Vision, Architecture Objectives and
Architecture Principle Statements
Government Agency’s EA Framework
4.1 Analyze the EA requirements and findings from the
environment report to address the gaps. These gaps
would address what is currently missing and also what
is required to meet future needs
Document gaps i.e. EA requirements
and environment improvements
needed
4.2 Carry out questionnaire and/or brainstorming ses-
sions with key stakeholders to define the EA vision,
mission, architecture objectives and architecture
principles (these statements have to address gaps
identified in Step 2-1)
Draft EA Vision, Mission, Architecture
Objectives and Architecture Principles
4.3 Present and obtain approval from EA Governance
Committee
Approved EA Vision, Mission, Archi-
tecture Objectives and Architecture
Principles
4.4 From the EA Vision, mission, architecture objectives
and principles, define the EA framework structure
Draft EA Framework Structure
4.5 With the EA framework in place, design the archi-
tecture elements
Draft EA Architecture Elements
4.6 Fill up the framework by defining the EA Model and
the relationships between elements
Draft EA Model
4.7 To standardize the EA documents, create the EA
documentation standard
Draft EA Documentation Standard
4.8 Similarly, to ensure quality, define the EA artifact
management processes
Draft EA Artifact management pro-
cesses
4.9 Present the outputs from 4.4 to 4.8 and obtain ap-
proval from EA Governance Committee
Approved EA Framework
Table ‎14-13: Stage 4 steps
314
National Overall Reference Architecture (NORA) – Handbook
STAGE 5: Build Reference Models
Item Description
Summary The previous section has defined and described the reference models
and architectures. Based on the EA framework developed previously, this
stage is all about building the reference models so that a government
agency can have standard views and taxonomies of key organizational
assets and processes such as business, application, data and technology
domains.
Purpose The purpose of stage 5 is to architect and build the relevant EA reference
models of the government agency.
Initiation This stage requires the EA vision, mission, architecture goals & principles, and
the EA framework from the previous stage. In addition, the government agency
needs to refer to Yesser’s NEA Reference Models. By referring to the NEA refer-
ence models, the government agency can develop their own reference models
ensuring alignment with whole of government as well as to achieve its EA goals.
Table ‎14-14: Stage 5 summary
315
National Overall Reference Architecture (NORA) – Handbook
Stage /
Step No
Description Deliverable
5 Document Government Agency’s Reference
Models
Government Agency’s Reference
Models
5.1 Develop a model that standardizes perfor-
mance elements for improving IT projects
and their quality. Obtain approval from the
EA Governance Committee
Approved Performance Reference
Model
5.2 Develop a model that classifies and defines
business functions and related information.
Obtain approval from the EA Governance
Committee
Approved Business Reference
Model
5.3 Develop a model that classifies and defines
shared application systems/components to
promote service integration and reuse by
identifying redundant or correlated appli-
cations. Obtain approval from the EA Gov-
ernance Committee
Approved Application Reference
Model
5.4 Develop a model that classifies data and
defines standard data structures to support
data architecture development, data stan-
dard, and data reuse. Obtain approval from
the EA Governance Committee
Approved Data Reference Model
5.5 Develop a model that classifies and defines
technologies and technology standards/
specifications, which support business
and services. Obtain approval from the EA
Governance Committee
Approved Technology Reference
Model
Table ‎14-15: Stage 5 steps
316
National Overall Reference Architecture (NORA) – Handbook
STAGE 6: Build Current Architecture
Item Description
Summary The focus of this stage is in capturing the current architectures of the government
agency so that the agency can clearly understand its IT and business landscapes. This
would allow a better visibility of the interconnections among different architectures
and components, and aid in analyzing the agency’s issues, challenges and opportuni-
ties relating to business, information/data and technologies.
Purpose The purpose of this stage is to analyze and document the status of the current govern-
ment agency’s IT and business landscapes.
Initiation The completion of the relevant reference models from the previous stage.
Table ‎14-16: Stage 6 summary
Stage /
Step No
Description Deliverable
6 Build Government Agency’s Current Architectures Government Agency’s Relevant Current Ar-
chitectures
6.1 Capture current business and IT data Government Agency’s Current Data
6.2 Analyze and build the business architecture that
describes the current business functions, sub-
business functions, business processes, business
activities and business services
Government Agency’s Current Business Ar-
chitecture
6.3 Analyze and build the application architecture
that lists all the current applications (fully auto-
mated, partial automated & manual), and the
relationships between these applications and the
business functions / processes / services
Government Agency’s Current Application
Architecture
6.4 Analyze and build the data architecture that
shows all the current data used by the govern-
ment agency, the usage of data by applications
including data exchange within and externally
Government Agency’s Current Data Archi-
tecture
6.5 Analyze and build the technology architecture
that illustrates the current IT infrastructure used
by the various applications, data and people
Government Agency’s Current Technology
Architecture
6.6 Current Architecture Analysis Summary of Improvement Opportunities
Table ‎14-17: Stage 6 steps
317
National Overall Reference Architecture (NORA) – Handbook
STAGE 7: Build Target Architecture
Item Description
Summary With the completion of the government agency’s current architectures, this stage de-
velops the target architectures. As a blueprint for the government agency to realize its
goals and desired outcomes in 3 to 5 years, the target architecture defines the improved
business and IT landscapes.
Purpose The purpose of this stage is to analyze, design and document the target government
agency’s IT and business landscapes.
Initiation The completion of the relevant current architectures from the previous stage.
Table ‎14-18: Stage 7 summary
Stage /
Step No
Description Deliverable
7 Build Government Agency’s Target Architectures Government Agency’s Relevant
Target Architectures
7.1 Define directions for developing target architecture
by analyzing environmental factors such as agency’s
vision/principles, current architectures etc.
Target Architecture direction
7.2 Analyze and build the target business architecture
based on architecture principles, current business
architecture’s analysis result, and current business
architecture deliverables.
Government Agency’s target
Business Architecture
7.3 Analyze and build the target application architecture
based on architecture principles, current application
architecture’s analysis result, and current application
architecture deliverables.
Government Agency’s target
Application Architecture
7.4 Analyze and build the target data architecture based
on architecture principles, current data architec-
ture’s analysis result, and current data architecture
deliverables.
Government Agency’s target
Data Architecture
7.5 Analyze and build the target technology architecture
based on architecture principles, current technology
architecture’s analysis result, and current technology ar-
chitecture deliverables.
Government Agency’s target
Technology Architecture
Table ‎14-19: Stage 7 steps
318
National Overall Reference Architecture (NORA) – Handbook
STAGE 8: Develop Transition Plan
Item Description
Summary With the completion of the various target architectures in the previous stage, it
is now important to plan and manage the transition required from the current
landscapes to the desired target landscapes.
Purpose The purpose of this stage to manage the transition between the current state
to the target state.
Initiation The completion of the relevant target architectures from the previous stage.
Table ‎14-20: Stage 8 summary
Stage /
Step No
Description Deliverable
8 Develop Transition Plan Transition Plan
8.1 Define transition projects Transition project list
8.2 Prioritize transition  projects Prioritized transition project list
8.3 Create transition roadmap Transition roadmap
8.4 Analyze and document required re-
sources and outcomes
Transition resource plan
8.5 Obtaining governance approval Approved transition roadmap and re-
source plan
Table ‎14-21: Stage 8 steps
319
National Overall Reference Architecture (NORA) – Handbook
STAGE 9: Develop Management Plan
Item Description
Summary This stage is about developing the EA usage and management plans so that EA
processes and values become an integral part of the agency standard operating
procedures. To ensure continued EA value delivery to the government agency, it
is necessary and important to incorporate EA management plans into the gov-
ernment agency.
Purpose The purpose of this stage is to analyze and document the plan in ensur-
ing the EA deliverables are accepted and use by the different stakehold-
ers in the government agency.
Initiation The completion of the activities in the transition stage.
Table ‎14-22: Stage 9 summary
Stage /
Step No
Description Deliverable
9 Develop Management Plan Management Plans
9.1 Develop EA usage plan EA usage plan
9.2 Develop EA management plan EA management plan
9.3 Obtaining governance approval Approved EA usage and management plans
Table ‎14-23: Stage 9 steps
STAGE 10: Execute and Maintain
Item Description
Summary This is the last stage where a government agency executes and maintains its
EA. Having covered many stages in the EA journey, this last stage concerns with
taking actions to make the government agency’s EA into a reality.
Purpose The purpose of this stage is to implement the EA artifacts that were docu-
mented in the previous stages.
Initiation The completion of the activities in the previous management stage.
Table ‎14-24: Stage 10 summary
320
National Overall Reference Architecture (NORA) – Handbook
Stage /
Step No
Description Deliverable
10 Execute and Maintain On-going maintenance of the
Government Agency’s EA
10.1 Implement the EA Usage & Management Plan Nil
10.2 Implement the EA Transition Roadmap Nil
Table ‎14-25: Stage 10 steps
321
National Overall Reference Architecture (NORA) – Handbook
Annex B: NEA System and EAMS
Government agencies have mandate to fulfill and deliver excellent services concentrated on a
particular vertical. The single-minded focus of the government agency in delivering on their ver-
tical is paramount for success of government. However, there is a need for bringing a whole of
government view, not only for the coherency of government but also to improve on efficiency
and effectiveness across all verticals.
The NEA system can be defined as a central national repository use for the purpose of captur-
ing and facilitating a whole of government view.  The goals and objectives for the NEA System
is listed below.
Goals
The goal of this project is to build and operate a NEA system repository that aimed at achiev-
ing NEA Goals and Objectives. This is realized by capturing the information outlined in the NEA
Meta model covering elements of Business and IT.
Objectives
1.	 Implement NEA repository system to assist in whole-of-government IT planning
2.	 Facilitate identification of areas for reuse of services, components, systems etc.
3.	 Capturing the big picture of whole-of-government IT landscape and IT assets.
B1. NEA System Overview
The following system context is used to represent the relevant systems and the key users from a
context point of view, they do not include the details regarding the exact type of systems being
used to provide the required functionality. The purpose of the below diagram is to illustrate the
possible systems/users that is part of the solution.
322
National Overall Reference Architecture (NORA) – Handbook
NEA Repository system
Agency User
HTTPS
Agency EA
System
NEA System Admin
API
NEA Meta-Model
HTTPS
CSV
Excel
NEA Member
HTTPS
Public User
HTTPS
NEA Data Analyst
HTTPS
Planning System
Procurement
System
Budget
System
Audit System
National Project
System
API
E Gov Action Plan
BRM ARM DRM
Business Service
Transf Plan IT Project App Systm
Sys Fnct Software Hardware
NEA Maturity Model
Workflow
Service Repository E Forms CRM
Qiyas System
API - Sync
Saudi Portal
Yesser Portal
Existing Yesser Systems
Import
WS
WS
WS
NEA Portal
Figure ‎14-2: NEA System Context
Following are the key elements from the System Context and their purpose in the NEA  System.
Agency User: - User from Agency.
Agency EA System: - EA Management system from an Agency.
Public User: - Individual Users who has access to the public information in NEA Repository
External Systems: The NEA repository system needs to interact with other external systems
to gather specific information, such other systems are systems related to Planning, Budgeting,
Procurement, Audit and National Projects etc.
GSB: Yesser has established GSB in order to facilitate integration and exchange of shared gov-
ernment data among various agencies interlinking with GSB. Considering dependency of gov-
ernment services that necessitate interlinking and integration of each agency with other agen-
cies in order to deliver a particular service, GSB plays a pivotal role in facilitating business and
technology integration among government agencies
Other Existing Yesser Systems:
323
National Overall Reference Architecture (NORA) – Handbook
Other related Yesser systems and the relevant information with respect to NEA repository are
listed below:
1.	 Service Repository: The Service repository holds the information regarding the core services de-
livered by the Government Agencies
2.	 Qiyas System: This system is used to measure the e-Transformation across all the government
agencies
3.	 E Forms: Agencies utilize the E Forms system to request services like fund request from Yesser
4.	 CRM: The CRM system for Yesser, the system is Microsoft CRM
5.	 Saudi Portal: It is the national portal of KSA, it also holds the information regarding Services of-
fered by government agencies, in addition to other relevant information.
6.	 Yesser Portal: The portal exposes services from Yesser provided to the government agencies.
B2.Agency EAMS
The EA Management System or EAMS is an important component in the NEA Repository system
context.
Most agencies would prefer to keep their agency-wide information in an EAMS. This would
make it convenient for the agency to extract information from its own EAMS and contribute
towards whole of government view within the NEA Repository.
The information from EAMS can be sent to the NEA System either by using appropriate API’s or
via exporting data from the EAMS and importing it into NEA System.
324
National Overall Reference Architecture (NORA) – Handbook
Annex C: NEA Meta-Model
C1. Overview of NEA Meta-model
NEA Meta-model comprises of national and agency level elements. The national level elements
try to capture information for whole of government approach from strategic, business, technol-
ogy and data point of view. Agencies provide information regarding similar aspects addressing
the scope at agency level. The elements are linked together strategically as well as taxonomi-
cally to provide end-to-end visibility to the e-Government ecosystem.
Agency E-
transformation
plan
Business
service(SRS)
IT project
Application
system
Data HardwareSoftware
Objectives
DRM ARM
Data Centre
Figure ‎14-3: NEA Meta-Model
325
National Overall Reference Architecture (NORA) – Handbook
C2. Objectives of NEA Meta-Model
The primary objective of NEA Meta-model 1.0 is to define a whole-of-government national
Meta-model and toward establishing a whole-of-government architecture. Other objectives are
as listed below:
1.	 Enhancing understanding about agency’s EA components and standard related information
2.	 Proposing necessary items that agency should apply in order to link agency’s EA information with
whole-of-government NEA
3.	 Capturing the current architecture of whole-of-government at the same time keeping it minimal-
istic demands for agencies
4.	 Providing sufficient linkages to ensure consistency
5.	 Flexibility to accommodate more elements in future as need arises.
326
National Overall Reference Architecture (NORA) – Handbook
C3. NEA Meta-Model Classes
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Agency
e-Transformation
Plan
ID ID ID
Name Name
Name of Agency e-Transfor-
mation plan
Description Content
Detailed description of
Agency
E-transformation plan
Planned Start
Month
Date
Planned End
Month
Date
Budget Currency
Budget allocated for this
Plan
Objective
ID ID ID of Objective
Objective Name Objective
Description Content
Detailed description
of Objective
Related items
Agency
e-Transformation
Plan
Agency e-Transfor-
mation Plan ID
RefID
IT Project
Name Name Name of IT project
Description Content
Detailed description of IT
project
MoF Project
code
Code MoF Project code
Type Enum
Consultation
Development
Purchasing
Maintenance &
Operation
Licensing
Others
All project types rather
than the above
ⓞ Other types Content
Detailed contents in case IT
project type is others
Status Code
In preparation
Ongoing
Close
327
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Start month
Month/
Year
MM/YYYY
Project start month/year in
Gregorian
Ex) 05/2013
End month
Month/
Year
MM/YYYY
Project end month/year in
Gregorian
Ex) 05/2014
Project Owner Ex) Yesser, MCIT, etc.
Related items
Agency e-Transformation Plan
Agency e-Transfor-
mation Plan ID
RefID
Objective Objective ID RefID
Application
system
Name Name
Name of App
system
Ex) ERP system, HR
system
Introduction
method
Enum
Purchase
Classification of App, sys-
tem’s introduction method
Dissemination from other
agencies
Outsourcing Development
Self-Development
Others
ⓞ Other
methods
Content
Detailed contents in case
introduction method is
others
Purpose Content
Objective of common
system’s introduction
※reason for being devel-
oped, for which business it
was developed, etc
Development
Year
Year YYYY
Initial development year
of Application system in
Gregorian
Ex) 2010
Development
language
Code
Java
Programming Language or
Development tool used to
build this application
C, C++, .net
Oracle Developer/ADF
PHP
Others
Development
Language
Version
Version
Development Language
Version
328
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Other lan-
guages
Contents
Detailed contents in case
Development language is
others
Application
Domain
Enum
Acquisition Management
Customer Service
Emergency Management
Financial Management
Grants Management
Workforce Management
Human Resource Manage-
ment
Legal
Physical Safety
Property and Asset Manage-
ment
Security Management
Systems Management
Application
User Interface
Enum
Web Based Application
Window Based Application
Others
Type of Ser-
vice Delivered
Enum
Core Business Services
Supportive Business Services
Internal Use Only
ⓞ Related Law Name
The name of App. system
related Law
Total develop-
ment cost
Number SAR
Total cost of App. system
development excluding
hardware and software
Ex) 100,000 SAR
Annual main-
tenance cost
Number SAR
Total cost of App. system
maintenance excluding
hardware and software
maintenance
Ex) 100,000 SAR
329
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Cloud Plan Enum
Yes
Weather App. system has
cloud plan or not
No
Already adopted
Don’t know
Relationships
Data
Name
Hardware
Name
Software
Name
IT project
Name
Busi-
ness
ser-
vice
Name
Hardware
Name
Type Enum
Server
Type of introduced hard-
ware
Storage
Security tool
Backup Tool
Others
ⓞ Other types Content
Writing down relevant de-
tailed contents in case the
type of hardware is others
Ex) L4 switch, Scanner  etc.
330
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Hardware
ⓞDetailed type
of hardware
Enum
Serv-
er
Unix
NT(Windows)
Linux
Mainframe
Others
Stor-
age
SAN Storage
NAS Storage
Others
Secu-
rity
tool
Firewall
IPS/IDS
VPN
DDos
Others
Back-
up
Tool
Tape library
VTL
Others
Oth-
ers
Vender Enum
HP
Name of hardware manu-
facturer (writing down
manufacturer’s name, not
supplier’s name)
IBM
SUN
FUJITSU
DELL
HITACHI
INTEL
EMC
HITACHI
BROCADE
McDATA
ADIC
Overland
Quantum
Others
Model name Name
Name of hardware named
by its manufacturer
331
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Hardware
OS name Enum
AIX
Name of OS loaded in
hardware
Linux
Windows
HP Unix
Solaris
Others
ⓞ Other OS
names
Content
Writing down OS name in
case OS name is others
Introduction
year
Year YYYY
Writing down the year
when the machine is in-
stalled in Gregorian year
Ex) 2009
Business
Severity
Enum
Mission Critical
Critical
Medium
Low
Total cost Number SAR
Total cost of the hardware
installation
Ex) 100,000 SAR
Annual main-
tenance cost
Number SAR
The cost of hardware an-
nual maintenance cost
Ex) 100,000 SAR
Software Name Name
Software means
common use or
sharing software
※ inputting it with
the form of ‘hard-
ware name_soft-
ware purpose’
Ex) ERP_DB server_
DBMS, ERP_DB
server_WAS, etc.
332
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Software
Type Enum
Operating system
WEB/WAS
Middle ware
DBMS
Modeling tool
Graphic tool
Mail
Virus Vaccine
Others
ⓞOther types Content
Vender Enum
CentOS
Name of software manu-
facturer (writing down
manufacturer’s name, not
supplier’s name)
Ex) Oracle
HP
IBM
Microsoft
RedHat
Oracle
SUSE
VMware
Apache
MySQL
SAP
PostgreSQL
Others
Name of SW Name
Name of software named
by its manufacturer
Ex) Oracle DBMS 10g
Introduction
year
Year YYYY
Writing down the year
when the SW is installed in
Gregorian year
Ex) 2009
Total cost Number SAR
Total cost of the SW instal-
lation
Ex) 100,000 SAR
Annual main-
tenance cost
Number SAR
The cost of SW annual
maintenance cost
Ex) 100,000 SAR
333
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Software
License Policy Code
User
Software’s license manage-
ment policy
CPU
Server
Site
Simultaneous Access
Others
Other  license
polices
Content
Relevant detailed contents
in case license policy is
others
Number of
license
Number
Data
Name Name
Name of data
※ It is a ‘data entity’
which represents a
data subject from
the common data
model that is used
in the conceptual or
logical data model.
(See Appendix )
Description Contents
Type Enum
Structured
UnStructured
334
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Data
Data
Classification
Enum
Location,
Pollution,
Overseas Saudi,
Traffic Information,
Weather,
Law,
Licensing,
Policy,
Individual,
Public Official,
Resident,
Umrah & Haj Visitor,
Relationship between Indi-
vidual & Organization,
Organization,
Political Service,
National Service,
Document,
Patent,
Library,
Statistics,
Book Categories,
Natural Resources,
Movable Asset,
Human Resources,
Real estate,
Budget,
Accounting,
Tangible Assets,
Intangible Assets
335
National Overall Reference Architecture (NORA) – Handbook
Component Property
Item
Domain
Domain
Restric-
tion
Explanation
Data Centre
Name Name Name of data
※ It is a ‘data entity’
which represents a
data subject from
the common data
model that is used
in the conceptual or
logical data model.
(See Appendix)
Classification Enum Tier 1
Tier 2
Tier 3
Tier 4
Location Name
Table ‎14-26: NEA Meta-Classes
Component Property Item Domain
Domain
Restriction
Explanation
Business
service
Agency Name Name
Name of business service Name
Business service description Content
Service Number Text
Service Output Name
Table ‎14-27: NEA business service Meta-Class
336
National Overall Reference Architecture (NORA) – Handbook
Annex D: e-Government
Transformation Plan
D1. Mandates of A Government Entity
Every government agency in the KSA has specific mandates to fulfill for instance the e-
Government program of Yesser was founded since the government of KSA attaches great
importance to transformation to  e-Government, due to the enormous benefits of e-Gov-
ernment concepts to the national economy.
Royal Decree (133) dated 21/05/1424 assigned responsibility towards management, planning and
development of the CIT sector, including launching e-Government, to Ministry of Communication and
Information Technology (MCIT).
Royal Decree (7/B/33181) dated 10/07/1424 H referred to MCIT the responsibility of establishing
a plan to deliver e-Government services and procurement of necessary resources.
Which resulted in the formulation of Yesser as an entity with mandates that it needs to deliver
on. Based on this an entity would establish their vision, mission goals and objectives.
D2. Strategic e-Government Transformation in an Agency
“Strategic Management is trying to understand where you will fit in tomorrow’s world and de-
ciding where you want to be and – getting there” :- Jack Welch
The business strategy tries to answer 3 to 4 fundamental questions:
•	 Whom to serve? - WHO
•	 What to offer?- WHAT
•	 How to serve? - HOW
•	 Who should Serve? – BY WHOM
337
National Overall Reference Architecture (NORA) – Handbook
The WHO and WHAT are part of business strategy and is dictated by the government agency
mandates. HOW and by WHOM is addressed by means of strategic management. The business
Strategy and strategic management are guided by Vision, Mission and Objectives of the gov-
ernment agency and the National Strategy and Saudi e-Government action plans.
So it is expected that an agency has a business strategy, captured by tools like balance score
card, strategic management (and implementation) captured by tools like value chain or 7s
framework.
In organizations that have a sizable and mature IT division would develop their own IT strategy in
line with the Business Strategy of the agency.
The diagram below describes the various components of strategy management in an orga-
nization.
338
National Overall Reference Architecture (NORA) – Handbook
Agency Mandates
MissionVision Objectives
Business Model Today Business Model Tomorrow
Business Strategy
IT Strategy
National Strategy
& e- Government
Action Plan
BalanceScoreCardValueChain
Figure ‎14-4: Components of Strategic Management in government agency
D3. Overview of e-Government Transformation Plan
The e-Government Transformation Plan is a roadmap for the agency to transform from the cur-
rent state to an organizationally optimized and seamlessly integrated business functions and pro-
cesses supported by an efficient ICT capability using Enterprise Architecture Methodology. The
ultimate objective of the plan is to help the government agencies become more citizen-centered,
service focused, efficient, process driven and result oriented. The plan mainly focuses on improv-
ing government processes, connecting to citizens (through e-Services) and building standard inter-
actions/integrations within and across the agencies.
339
National Overall Reference Architecture (NORA) – Handbook
D4 How to use NORA for developing e-GovernmentTransformation Plan
The organization is required to map its current and future  architecture states in relation to the
business and IT perspectives and subsequently prepare an architecture roadmap and imple-
mentation governance that closes the gap between the two states - in other words, a blueprint
of the organization’s ICT-enabled business.
By utilizing NORA the agency produces the following deliverables:
•	 Current Architecture – By completing stage 6 of NORA ( Build Current Architecture)
•	 Target Architecture – By completing stage 7 of NORA ( Build Target Architecture)
•	 Analysis that identifies the shortfalls of the current state in terms of its ability to support the
objectives and strategies of the business, with respect to future state ( Part of Stage 6 and
Stage 7 of NORA)
•	 Transformation Plan (i.e. e-Government Strategic Transformation Plan) that defines the
initiatives required to migrate from the current state into the future state. This is delivered
as part of stage 8 of NORA.
340
National Overall Reference Architecture (NORA) – Handbook
Agency Mandates
MissionVision Objectives
Business Model Today Business Model Tomorrow
Business Strategy
IT Strategy
National Strategy
& e- Government
Action Plan
Transformation Plan
BalanceScoreCardValueChain
Figure ‎14-5: Linking strategy and e-Government transformation
The activities that need to be performed in carrying out this exercise is not exactly IT driven, it
is linked directly to government entity mandates, National Strategy and Action Plans, business
strategy and strategy management of the government entity. This also implies that the ade-
quate involvement of not only executives of the agency but also the strategic and operational
stakeholders are needed as well. Figure 14.5 illustrates the linkage of e-Transformation plan
with components of strategy within the agency.
341
National Overall Reference Architecture (NORA) – Handbook
D5. Relevant Artifacts for e-Government Transformation
The agency e-Government Transformation plan comprises artifacts that represent:
•	 Current State Enterprise Architecture
•	 Artifacts related to Current Business Architecture
•	 Artifacts related to Current Application Architecture
•	 Artifacts related to Current Data Architecture
•	 Artifacts related to Current Technology Architecture
•	 Future State Enterprise Architecture
•	 Artifacts related to Future Business Architecture
•	 Artifacts related to Future Application Architecture
•	 Artifacts related to Future Data Architecture
•	 Artifacts related to Future Technology Architecture
•	 Analysis that identifies the shortfalls of the current state in terms of its ability to support the
objectives and strategies of the business, with respect to future state.
•	 Artifacts that lists new ideas, gaps and opportunities for improvement in Business,
Application, Data and Technology Domains
•	 Transformation Plan (i.e. e-Government Strategic e-Transformation Plan) that defines the
initiatives required to migrate from the current state into the future state.
•	 Artifact that Represents e-Government Transformation Plan, which comprise of logi-
cally grouped projects linked to the above list, their priorities and their respective
timelines.
342
National Overall Reference Architecture (NORA) – Handbook
Business Model Today Business Model Tomorrow
Transformation Plan
Business
Applications
Data
Technology
Business
Applications
Data
Technology
NORA
EAPractice
Figure ‎146: Relevant artifacts for e-Government Transformation Plan
The e-Government Transformation Plan comprise of a set of NORA Artifacts and NORA Work
Products, artifacts are the end deliverables from a NORA stage, whereas work products are the
interim documentation or data collected or reports made while creating those deliverables.
The below table shows the exhaustive list of the artifacts part of the e-Government Transforma-
tion Plan.
343
National Overall Reference Architecture (NORA) – Handbook
NORA Stage NORA Artifacts
NORA Work
Products
Develop EA Strategy, Develop EA
Project Plan and Analyze Current
State.
EA Strategy Agency’s Vision, Mission,
Objectives and Initiatives.
SWOT Analysis Agencies IT Project List
Current IT Landscape
Develop EA Framework Agencies EA Mission, Vision,
Objectives
Agencies Architecture Principle
Agency PRM, BRM, ARM, DRM,
TRM wherever applicable
Build Current Architecture and
Target Architecture
Organization Chart
Business Function
Business Process
Service Catalogue
Build Current Architecture and
Target Architecture
Application Overview
Application Catalogue
Application Function
Application Relationship
Build Current Architecture and
Target Architecture
Data model Overview
Dataflow Diagram
Data Logical Diagram
Data Dictionary
Database Portfolio Catalogue
Build Current Architecture and
Target Architecture
Infrastructure Overview
Infrastructure Description
HW and SW Catalogue
Build Current Architecture ,Target
Architecture and Build Transition Plan
Current Architecture Analysis List of Improvement Ideas or
Gap AnalysisDirections for Target Architecture
Target BA, AA, DA, TA
Prioritized Project List
Project Roadmap
Transition Plan
Table ‎14-28: List of artifacts for e-Government Transformation Plan
344
National Overall Reference Architecture (NORA) – Handbook
D6. Exhaustive list of e-Government Transformation artifacts
The exhaustive list of artifacts that are of use in building the e-Government Transformation plan
is listed below, although all of them are not mandatory but it does help in constructing a better
picture and hence to plan better.
1.	 Vision
2.	 Message/Mission
3.	 Strategic Goals
4.	 Risks &Challenges
5.	 Stakeholders
6.	 Values & Principles
7.	 Conceptual Model
8.	 Organizational Structure
9.	 Services
10.	 Processes
11.	 Business Requirements
12.	 Business Gaps
13.	 Listing Applications
14.	 Listing Applications Modules
15.	 Relations between Applications
16.	 Applications Requirements
17.	 Applications Gaps
18.	 Data Entities
19.	 Relationships between Data Entities & Applications
20.	 Relationships between Data Entities and Business Structure
21.	 Methods of Data Management and its security
22.	 Data Requirements
23.	 Data Gaps
24.	 Listing Technology Components.
25.	 Technology References Definition.
26.	 References of Technology security.
27.	 Relationships between Technology Components &Information Systems.
28.	 Technology Infrastructure Requirements
29.	 Counting Technology Gaps
30.	 Gaps Listing
31.	 Definition of initiatives and future projects
32.	 Roadmap for Transformation
345
National Overall Reference Architecture (NORA) – Handbook
Annex E: NEA EA maturity model
The EA Core team can evaluate and measure its EA maturity. The team can obtain the EA Matu-
rity measurement from NEA, Yesser. This maturity measurement should be done on an annual
basis. From the maturity index, the EA Core team can reflect and re-plan how they can improve
their EA execution.
Since the government agency will be assessed on its EA, the Core team has to understand the
National EA Maturity Model that has 5 maturity levels.
1.	Initial or Informal
2.	Under Development
3.	Defined
4.	Managed
5.	Optimizing.
It also has 5 components or areas of measurement - EA Process, EA Development, Business
Linkage, Senior Management Involvement and EA Communication. Figure 14-7 illustrates the
NEA EA Maturity Model while Table 14-29 describes the details of each level.
Figure ‎14-7: NEA EA maturity model
346
National Overall Reference Architecture (NORA) – Handbook
Maturity
Component /
Maturity Level
Measurement Description
EA Process Is there an established EA process?
1 Ad-hoc EA processes exist
2 Basic EA processes are defined
3 The EA processes are well defined and all of them are documented
4 The EA processes are part of the culture and are linked to business & IT
processes
5 The EA processes are optimized and continuously improved based on
quality metrics
EA Development To what extent are the EA documents and deliverables provided by EA
(team/division/office)?
1 Ad-hoc EA documentation and standards exist
2 Basic EA documentation such as ‘Organization structure diagram’, ‘Appli-
cation architecture diagram’, ‘Data entities diagram’ and more than one
of ‘Reference models’ exist
3 All of EA documentation such as Current architecture, Target architec-
ture, Gap analysis and Migration plan, ‘5 Reference models(PRM, BRM,
ARM, DRM, TRM)’, and ‘Meta model’ exist
4 Updated EA documentation exists to reflect the major IT and business
changes
5 EA documentation is continuously or periodically updated to reflect all IT
and business changes
Business Linkage To what extent is the EA linked to business strategies or drivers?
1 Minimal or implicit linkage to business strategies or business drivers
2 Explicit linkage to business strategies or drivers. , EA is involved in the
initiation of any new business initiatives
3 EA is integrated with Business processes management. Explicit linkage to
business drivers and information requirements
347
National Overall Reference Architecture (NORA) – Handbook
4 Business processes management are adjusted based on the feedback re-
ceived and lessons learned from updated EA. Periodic re-examination of
business drivers
5 EA metrics are used to optimize and drive business linkages.  Business
involved in the continuous process improvements of EA
Senior Management
(CEO/CIO/Director)
Involvement
To what extent are the senior management involved in the establishment
and ongoing development of the EA?
1 EA Core team is established but Limited management team awareness or
involvement in the EA process
2 Occasional / selective senior management (IT Director) involvement with
the EA Core team and in EA Process with various degrees of commitment
3 Senior-management team (IT Director) aware of and supportive of the
EA process
4 Senior-management team (CIO) directly involved in the EA review    process
5 Senior-management team (CEO) directly involved in the optimization of
the EA development process and governance
EA Communication To what extent are the decisions of EA practice documented?
1 Using ad-hoc tools for EA documentation, for example Visio diagrams,
Word documents and Excel sheets
2 The operating unit’s EA  documentation is available on webpage based on
ad-hoc tool information, this can be internal webpage or external
3 The operating unit EA webpages are updated periodically and are used to
document EA deliverables
4 EA documents updated regularly on EA web page and EA tools are used
to support maintaining and managing EA documentation
5 EA documents frequently reviewed for latest EA developments / stan-
dards with awareness session to IT staff on EA content
Table ‎14-29: EA maturity components & levels
348
National Overall Reference Architecture (NORA) – Handbook
Annex F: Business Service Attributes
Every government entity is mandated to provide information regarding their business services
into the Marsad system. The table below lists all the attributes the agency need to provide.
S/
No
Attributes in Arabic Attributes In English Value
1 ‫الخدمة‬ ‫رقم‬ service number
2 ‫عربي‬ - ‫الخدمة‬ ‫اسم‬ Service Name-Arabic
3 ‫انجليزي‬ - ‫الخدمة‬ ‫اسم‬ Service Name-English
4 ‫للخدمة‬ ‫المقدمة‬ ‫اإلدارة‬ Service provider department
5 ‫الخدمة‬ ‫نوع‬ service type
6 ‫الخدمة؟‬ ‫تصنيف‬ Service classification
7 ‫المستفيد؟‬ ‫حسب‬ ‫الخدمة‬ ‫نوع‬ service type by the beneficiary
8 ‫الجغرافية‬ ‫التغطية‬ Geographic coverage
9 ‫الخدمة‬ ‫على‬ ‫الحصول‬ ‫رسوم‬ Service fee
10 ‫الوطنية‬ ‫الميزانية‬ ‫من‬ ‫الخدمة‬ ‫تمويل‬ ‫تم‬ ‫هل‬
‫الحكومية؟‬ ‫اإللكترونية‬ ‫للتعامالت‬
Is the service has been funded by the national e-
Government budget?
11 ‫على‬ ‫للحصول‬ ‫باأليام‬ ‫المستغرق‬ ‫الوقت‬
‫الراهن‬ ‫الوضع‬ ‫(خالل‬ ‫)الخدمة‬
The time consumed(By days) to provide the ser-
vice (through the status quo)
12 ‫على‬ ‫للحصول‬ ‫باأليام‬ ‫المستغرق‬ ‫الوقت‬
‫المستقبلي‬ ‫الوضع‬ ‫(خالل‬ ‫)الخدمة‬
The time consumed(By days) to provide the ser-
vice (during future status)
13 ‫للجهة‬ ‫تابعة‬ ‫الخدمة‬ ‫لتقديم‬ ‫مواقع‬ ‫هناك‬ ‫هل‬
‫الرسمي‬ ‫الدوام‬ ‫وقت‬ ‫خارج‬ ‫تعمل‬
Are there Service channels outside official work-
ing time?
14 ‫لدى‬ ‫بيانات‬ ‫أو‬ ‫خدمات‬ ‫على‬ ‫الخدمة‬ ‫تعتمد‬ ‫هل‬
‫أخرى؟؟‬ ‫حكومية‬ ‫جهات‬
Does the service rely on other government agen-
cies services and data  ?
15 ‫جهات‬ ‫لدى‬ ‫خدمات‬ ‫الخدمة‬ ‫هذه‬ ‫تدعم‬ ‫هل‬
‫أخرى؟؟‬ ‫حكومية‬
Does the service support other government agen-
cies services?
16 ‫الرقمي‬ ‫التصديق‬ ‫خاصية‬ ‫تفعيل‬ ‫تم‬ ‫هل‬
‫لمستفيدي‬ ‫الرقمي‬ ‫التصديق‬ ‫شهادة‬ ‫وإصدار‬
‫الخدمة؟؟‬ ‫هذه‬ ‫ومستخدمي‬
Is digital certification feature activated? Is issuing
digital certification for the beneficiaries and users ac-
tivated?
17 ‫الخدمة؟‬ ‫نضج‬ ‫مستوى‬ Service maturity level
349
National Overall Reference Architecture (NORA) – Handbook
18 ‫اليه‬ ‫الوصول‬ ‫يمكن‬ ‫الخدمة‬ ‫لنضج‬ ‫مستوى‬ ‫أعلى‬ The highest service maturity level can be reached
19 ‫النضج؟‬ ‫في‬ ‫األعلى‬ ‫للمستوى‬ ‫الخدمة‬ ‫انتقال‬ ‫تاريخ‬ Date of service transmission to the next level of
maturity
20 ‫الخدمة‬ ‫من‬ ‫المستهدفين‬ ‫عدد‬ The targeted beneficiaries number of service
21 ‫بشكلها‬ ‫سنويًا‬ ‫الخدمة‬ ‫من‬ ‫المستفيدين‬ ‫عدد‬
‫االلكتروني‬
The number of service beneficiaries (electronic
form) annually
22 ‫السنة‬ ‫خالل‬ ‫االلكترونية‬ ‫العمليات‬ ‫عدد‬ The number of electronic transactions annually
23 ‫الواحد‬ ‫للمستفيد‬ ‫الخدمة‬ ‫استخدام‬ ‫تكرار‬ Frequent use of service by a beneficiary.
24 ‫في‬ ‫الخدمة‬ ‫وحالة‬ ‫الخدمة‬ ‫أتمتته‬ ‫قابلية‬
‫الحالي‬ ‫وضعها‬
Service automation availability and current state
25 ‫متاحة؟‬ ‫الخدمة‬ ‫وإجراءات‬ ‫متطلبات‬ ‫هل‬ Are the requirements and procedures of service
available?
26 ‫إجراءاتها؟‬ ‫توثيق‬ ‫تم‬ ‫هل‬ Are the service procedures documented?
27 ‫الخدمة‬ ‫عمل‬ ‫مسار‬ ‫رسم‬ ‫تم‬ ‫هل‬ (workflow chart)‫؟‬ Is the service workflow chart designed ?
28 ‫هندستها‬ ‫إعادة‬ ‫أو‬ ‫إجراءاتها‬ ‫تحسين‬ ‫تم‬ ‫هل‬
‫)؟؟‬BPR/BPI(
Have the service procedures been improved  or
re-engineered (BPR / BPI)?
29 ‫موحدة؟‬ ‫الخدمة‬ ‫تقديم‬ ‫إجراءات‬ ‫هل‬ Are the procedures of providing the service unified?
30 ‫الخدمة‬ ‫تقديم‬ ‫قنوات‬ Service  channels
31 ‫عربي‬ - ‫للخدمة‬ ‫المباشر‬ ‫االلكتروني‬ ‫الرابط‬ Service link in the official websites - Arabic
32 ‫انجليزي‬ - ‫للخدمة‬ ‫المباشر‬ ‫االلكتروني‬ ‫الرابط‬ Service link in the official websites-English
33 ‫اليوتيوب‬ ‫على‬ ‫الفيديو‬ ‫رابط‬ Video link on YouTube
34 ‫اآللي‬ ‫بالرد‬ ‫الخاص‬ ‫االتصال‬ ‫رقم‬ IVR call number
35 ‫اإلستخدام‬ ‫لطريقة‬ ‫رابط‬ Service usage link
36 ‫الخدمة‬ ‫استخدام‬ ‫دليل‬ Service usage guideline
37 ‫عربي‬ - ‫الخدمة‬ ‫وصف‬ Service Description - Arabic
38 ‫انجليزي‬ - ‫الخدمة‬ ‫وصف‬ Service Description - English
39 ‫الخدمة‬ ‫تنفيذ‬ ‫خطوات‬ Service implementation steps
Table ‎14-30: Attributes of business service (Arabic & English)
350
National Overall Reference Architecture (NORA) – Handbook
351
National Overall Reference Architecture (NORA) – Handbook

الوثيقة المتكاملة للمنهجية الوطنية للبنية المؤسسية National Overall Reference Architecture

  • 1.
  • 2.
    2 National Overall ReferenceArchitecture (NORA) – Handbook Tableof Contents
  • 3.
    3 National Overall ReferenceArchitecture (NORA) – Handbook Table of Contents 1. Introduction 19 1.1. Document purpose 19 1.2. National Enterprise Architecture Framework 19 1.3. Values of NORA 19 1.4. Goals of NORA 20 1.5. Features of NORA 21 1.6. Target audience 21 1.7. Document structure 22 1.8. Related information 22 1.9. Contact information 22 2. Executive Summary 24 2.1. Need for Enterprise Architecture 24 2.2. Background of NEA Framework 26 2.3. Objectives of NORA 28 2.4. Defining a purpose for agency EA 28 2.5. NORA methodology 30 2.6. NORA relationship to NEA Framework 34 3. Stage 1 - Develop EA Project Strategy 36 3.1. Stage summary 36 3.2. Stage purpose 36 3.3. Stage initiation 36 3.4. Key steps in stage 1 36 3.4.1 Step 1.1 Analyze EA trends and case studies 38 3.4.2 Step 1.2 Provide EA awareness 39 3.4.3. Step 1.3 Assess government agency’s e-transformation maturity 40 3.4.4. Step 1.4 Document government agency’s EA project strategy 44 3.4.5. Step 1.5 Present and obtain approval for EA project strategy 46
  • 4.
    4 National Overall ReferenceArchitecture (NORA) – Handbook 4. Stage 2 - Develop EA Project Plan 48 4.1. Stage summary 48 4.2. Stage purpose 48 4.3. Stage initiation 48 4.4. Key steps in stage 2 48 4.4.1 Step 2.1 Set up EA committees and working teams 49 4.4.2. Step 2.2 Finalize EA development approach 54 4.4.3. Step 2.3 Document detailed EA project plan 63 4.4.4. Step 2.4 Present and obtain approval for the EA project plan 66 5. Continuous Governance 68 5.1. Purpose of governance 68 5.2. Outcomes of governance 68 5.3. Governance initiation 68 5.4. Key areas in EA governance 69 5.4.1. Program management 71 5.4.2. Change management 71 5.4.3. Capability management 79 5.4.4. Policy management 82 5.4.5. Performance management 85 6. Stage 3 – Analyze Current State 88 6.1. Stage summary 88 6.2. Stage purpose 88 6.3. Stage initiation 88 6.4. Key steps in stage 3 88 6.4.1. Step 3.1 Gather and document EA requirements 90 6.4.2. Step 3.2 Analyze internal environment 93 6.4.3. Step 3.3 Analyze external environment 100 6.4.4. Step 3.4 Present current state analysis 102
  • 5.
    5 National Overall ReferenceArchitecture (NORA) – Handbook 7. Stage 4 – Develop EA Framework 104 7.1. Stage summary 104 7.2. Stage purpose 104 7.3. Stage initiation 105 7.4. Key steps in stage 4 105 7.4.1. Step 4.1 Define EA’s vision and mission statements, & architecture objectives 106 7.4.2. Step 4.2 Define EA’s architecture principles 109 7.4.3. Step 4.3 Present and obtain approval for EA vision, mission and architecture objectives 111 7.4.4. Step 4.4 Define EA Framework structure 111 7.4.5. Step 4.5 Design EA architecture elements 113 7.4.6. Step 4.6 Design EA model 114 7.4.7. Step 4.7 Develop EA documentation standard 119 7.4.8. Step 4.8 Develop EA artifacts management processes 121 7.4.9. Step 4.9 Present and obtain approval for EA framework 121 8. About Reference Models & Architectures 123 8.1. Need for clarity 123 8.2. Definitions 123 8.3. Process to build reference models and architectures 125 8.4. Building blocks of reference models and architectures 127 8.5. Summary of deliverables for reference models and architectures 129 9. Stage 5 – Build Reference Models 133 9.1. Stage summary 133 9.2. Stage purpose 133 9.3. Stage initiation 133 9.4. About NEA reference models 134 9.5. Key steps in stage 5 136 9.5.1. Step 5.1 Build performance reference model 137 9.5.2. Step 5.2 Build business reference model 143
  • 6.
    6 National Overall ReferenceArchitecture (NORA) – Handbook 9.5.3. Step 5.3 Build application reference model 149 9.5.4. Step 5.4 Build data reference model 157 9.5.5. Step 5.5 Build technology reference model 164 10. Stage 6 – Build Current Architecture 173 10.1. Stage summary 173 10.2. Stage purpose 173 10.3. Stage initiation 174 10.4. Key steps in stage 6 175 10.4.1. Step 6.1 Capture current business and IT data 176 10.4.2. Step 6.2 Analyze and build current business architecture 179 10.4.3. Step 6.3 Analyze and build current application architecture 195 10.4.4. Step 6.4 Analyze and build current data architecture 208 10.4.5. Step 6.5 Analyze and build current technology architecture 220 10.4.6. Step 6.6 Current architecture analysis 237 11. Stage 7 – Build Target Architecture 246 11.1. Stage summary 246 11.2. Stage purpose 246 11.3. Stage initiation 247 11.4. Key steps in stage 7 247 11.4.1. Step 7.1 Define directions for developing target architecture 248 11.4.2. Step 7.2 Build target business architecture 252 11.4.3. Step 7.3 Build target application architecture 256 11.4.4. Step 7.4 Build target data architecture 260 11.4.5. Step 7.5 Build target technology architecture 264 12 Stage 8 – Develop Transition Plan 269 12.1. Stage summary 269 12.2. Stage purpose 269 12.3. Stage initiation 269
  • 7.
    7 National Overall ReferenceArchitecture (NORA) – Handbook 12.4. Key steps in stage 8 270 12.4.1. Step 8.1 Define transition projects 270 12.4.2. Step 8.2 Prioritize transition projects 271 12.4.3. Step 8.3 Create transition roadmap 274 12.4.4. Step 8.4 Analyze and document required resources and outcomes 277 12.4.5. Step 8.5 Obtain governance approval 279 13. Stage 9 – Develop Management Plan 281 13.1. Stage summary 281 13.2. Stage purpose 281 13.3. Stage initiation 281 13.4. Key steps in stage 9 282 13.4.1. Step 9.1 Develop EA usage plan 282 13.4.2. Step 9.2 Develop EA management plan 288 14. Stage 10 – Execute and Maintain 300 14.1. Stage Summary 300 14.2. Stage Purpose 300 14.3. Stage Initiation 300 14.4. Key Steps in Stage 10 301 14.4.1. Step 10.1 Implement the EA usage & management plan 301 14.4.2. Step 10.2 Implement the EA transition roadmap 305 Annex A : NORA Summary of Deliverables by Stages 307 Annex B : NEA System and EAMS 321 B.1. NEA System Overview 321 B.2. Agency EAMS 323 Annex C : NEA Meta-Model 324 C.1. Overview of NEA Meta-model 324 C.2. Objectives of NEA Meta-Model 325 C.3. NEA Meta-Model Classes 326
  • 8.
    8 National Overall ReferenceArchitecture (NORA) – Handbook Annex D :e-Government Transformation Plan 336 D.1. Mandates of A Government Entity 336 D.2. Strategic e-Government Transformation in an Agency 336 D.3. Overview of e-Government Transformation Plan 338 D.4. How to use NORA for developing e-Government Transformation Plan 339 D.5. Relevant Artifacts for e-Government Transformation 341 D.6. Exhaustive list of e-Government Transformation artifacts 344 Annex E : NEA EA maturity model 345 Annex F : Business Service Attributes 348
  • 9.
    9 National Overall ReferenceArchitecture (NORA) – Handbook Table of Figures Figure ‎2-1: Impact of EA on government 25 Figure ‎2-2: NEA Framework 26 Figure ‎2-3: NORA Methodology 33 Figure ‎3-1: Example of bottom-up development strategy 46 Figure ‎3-2: Example of mixed development approach 46 Figure ‎4-1: Example of EA organizational structure 51 Figure ‎4-2: Example of EA transition roadmap 59 Figure ‎4-3: Example format for EA project plan 65 Figure ‎5-1: Five Aspects of EA governance 70 Figure ‎5-2: Example of artifact review and approval process 74 Figure ‎53: Example for EA usage direction 83 Figure ‎54: Example for EA management plan direction 85 Figure ‎61: Example of Vision/Mission alignment with goals and initiatives 95 Figure ‎62: Example of business and IT alignment 97 Figure ‎63: Example of major IT systems supporting government functions 98 Figure ‎64: Example of IT systems supporting government functions by business areas 99 Figure ‎71: Example of a Vision statement 106 Figure ‎72: Example of EA architecture principles 110 Figure ‎73: EA Framework structure example 113 Figure ‎8-1: Basic process in building reference models and architectures 126 Figure ‎8-2: Building blocks / components 127 Figure ‎8-3: Same building blocks in NEA reference models 128 Figure ‎9-1: NEA reference models and their inter-relationships 134 Figure ‎9-2: NEA PRM artifacts 137 Figure ‎9-3: Example PRM purpose and direction 139 Figure ‎9-4: Example PRM strategic goals / outcomes 140 Figure ‎9-5: Example of PRM indicator description 142 Figure ‎9-6: NEA BRM artifacts 143 Figure ‎9-7: Example BRM purpose 146 Figure ‎9-8: Example of business area, LoB, business function and sub-business functions 147
  • 10.
    10 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎9-9: NEA ARM artifacts 149 Figure ‎9-10: Structured diagram of application systems, components and interfaces in NEA ARM 151 Figure ‎9-11: Agency ARM artifacts 152 Figure ‎9-12: Example ARM purpose or direction 153 Figure ‎9-13: Example of MOE’s business and sub-business functions 155 Figure ‎9-14: NEA DRM artifacts 157 Figure ‎9-15: NEA DRM 158 Figure ‎9-16: Agency DRM artifacts 159 Figure ‎9-17: Example for defining DRM purpose 161 Figure ‎9-18: Example for developing data classification structure 162 Figure ‎9-19: NEA TRM artifacts 165 Figure ‎9-20: Example TRM purpose 168 Figure ‎9-21: Example TRM structure 168 Figure ‎10-1: Data capturing activities 176 Figure ‎10-2: Difference between BRM and BA 180 Figure ‎10-3: BA artifacts’ relationship diagram 181 Figure ‎10-4: Organizational chart example 184 Figure ‎10-5: Business area, LoB, business function and sub-business function diagram example 186 Figure ‎10-6: The properties of business function description 189 Figure ‎10-7: Contents of a sub-business function 188 Figure ‎10-8: MOE’s sub-business function & business process relationship 189 Figure ‎10-9: Business process map example 192 Figure ‎10-10: Difference between ARM and AA 196 Figure ‎10-11: AA artifacts’ relationship diagram 197 Figure ‎10-12: Application overview example 200 Figure ‎10-13: Difference between DRM and DA 209 Figure ‎10-14: DA artifacts’ relationship diagram 210 Figure ‎10-15: Conceptual data model example 213 Figure ‎10-16: Logical data model example 214 Figure ‎10-17: Data flow diagram example 215 Figure ‎10-18: Difference between TRM and TA 221
  • 11.
    11 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-19: Relationship TA artifacts 222 Figure ‎10-20: Infrastructure overview example 225 Figure ‎10-21: WAN diagram example 227 Figure ‎10-22: LAN diagram example 228 Figure ‎10-23: Internet diagram example 229 Figure ‎10-24: WLAN diagram example 230 Figure ‎10-25: Storage diagram example 231 Figure ‎10-26: Server farm diagram example 232 Figure ‎10-27: Example BA analysis 238 Figure ‎10-28: Example BA improvement opportunities 239 Figure ‎10-29: Example AA analysis 240 Figure ‎10-30: Example AA improvement opportunities 240 Figure ‎10-31: Example DA analysis 241 Figure ‎10-32: Example DA improvement opportunities 242 Figure ‎10-33: Example TA analysis 243 Figure ‎10-34: Example TA improvement opportunities 243 Figure ‎11-1: Example of EA principles review and its implications 249 Figure ‎11-2: Example agency improvement opportunities for various architectures 250 Figure ‎11-3: Example of target architecture direction through overall analysis 251 Figure ‎11-4: Example of updated business function in target BA 254 Figure ‎11-5: Example of updated business processes in target BA 255 Figure ‎11-6: Example process to identify new application systems & architecture 258 Figure ‎11-7: Example of updated application function in target AA 259 Figure ‎11-8: Example of identified artifacts for updates in target DA 262 Figure ‎11-9: Example updated database diagram 263 Figure ‎11-10: Example of direction setting for in TA 266 Figure ‎11-11: Example of updated infrastructure overview in target TA 267 Figure ‎12-1: Example selection method for transition plan 271 Figure ‎12-2: Example of transition project 271 Figure ‎12-3: Example prioritization principles 272 Figure ‎12-4: Example priority assessment structure 273 Figure ‎12-5: Example priority assessment 273
  • 12.
    12 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎12-6: Example transition projects by stages 274 Figure ‎12-7: Example of goal setting for each stage 275 Figure ‎12-8: Example detailed schedule by each stage 275 Figure ‎12-9: Example resource estimation procedure 276 Figure ‎12-10: Example required resource classification 277 Figure ‎12-11: Example resource estimation 277 Figure ‎12-12: Example resource requirements by stage 277 Figure ‎12-13: Example expected outcome 278 Figure ‎13-1: Example for EA usage purposes 283 Figure ‎13-2: Example for EA usage scope 284 Figure ‎13-3: Example for EA usage tasks 286 Figure ‎13-5: Example for the relationship between EA tasks and artifacts 287 Figure ‎13-6: Example of EA management plan 289 Figure ‎13-7: Example of EA management scope 289 Figure ‎13-8: Example for EA management plan process 290 Figure ‎13-9: Example for EA management plan principles 290 Figure ‎13-10: Example for EA roles for large organization 292 Figure ‎13-11: Example for architect tasks 292 Figure ‎13-12: Example for EA update process 294 Figure ‎13-13: Example for EA change process 295 Figure ‎13-14: Example for EA diffusion process 295 Figure ‎13-15: Example for EA compliance review 296 Figure ‎13-16: Example for EA design exception process 296 Figure ‎13-17: Example for EA system design 297 Figure ‎14-1: Example for EA usage guideline 302 Figure ‎14-2: NEA System Context 322 Figure ‎14-3: NEA Meta-Model 324 Figure ‎14-4: Components of Strategic Management in government agency 338 Figure ‎14-5: Linking strategy and e-Government transformation 340 Figure ‎14-6: Relevant artifacts for e-Government Transformation Plan 342 Figure ‎14-7: NEA EA maturity model 345
  • 13.
    13 National Overall ReferenceArchitecture (NORA) – Handbook List of Tables Table ‎2-1: List of NEA Framework Components 27 Table ‎2-1: Common EA objectives / drivers 29 Table ‎3-1: Stage 1 steps 37 Table ‎3-2: EA value proposition to stakeholders 39 Table ‎3-3: Likely EA value proposition based on e-Transformation maturity 42 Table ‎3-4: Local examples for EA drivers or purposes 43 Table ‎3-5: Considerations for EA project strategy development 45 Table ‎4-1: Stage 2 steps 49 Table ‎4-2: Typical government EA committees and working teams 50 Table ‎4-3: Governance / Management fields 52 Table ‎4-4: Examples of governance / management fields in government agencies 53 Table ‎4-5: Examples of EA scope 55 Table ‎4-6: Examples of EA gradual scoping 56 Table ‎4-7: Development approach recommendations 57 Table ‎4-8: Budget categories for consideration 58 Table ‎4-9: Description on the EA usefulness 60 Table ‎4-10: Examples of EA usefulness categories 61 Table ‎4-11: Examples of EA usefulness 62 Table ‎5-1: Continuous governance steps 69 Table ‎5-2: Need for EA change management 72 Table ‎5-3: EA awareness methods 74 Table ‎5-4: Suggested content for EA awareness 76 Table ‎5-5: EA promotion activities 78 Table ‎5-6: Capabilities required in EA 81 Table ‎5-7: Activities to define EA usage plan 83 Table ‎5-8: Activities to define EA management plan 84 Table ‎5-9: Performance metrics example 86 Table ‎6-1: Stage 3 steps 89 Table ‎6-2: Example questionnaire 91 Table ‎6-3: Example format to gather EA requirements 92
  • 14.
    14 National Overall ReferenceArchitecture (NORA) – Handbook Table ‎6-4: Internal analysis areas & expected outcomes 93 Table ‎6-5: SWOT chart template 101 Table ‎7-1: Stage 4 steps 105 Table ‎7-2: Considerations for effective Vision & Mission statements 108 Table ‎7-3: Criteria examples of good architecture principles 109 Table ‎7-4: Examples of research areas for EA Framework 112 Table ‎7-5: Description of EA elements 114 Table ‎7-6: Activities to develop the EA Model 115 Table ‎7-7: EA Model view by stakeholders 116 Table ‎7-8: EA Model view by architecture 116 Table ‎7-9: Example of Yesser’s standard terms 120 Table ‎8-1: Differences between Reference Models and Architectures 125 Table ‎8-2: Summary of artifacts by reference models and architectures 129 Table ‎9-1: Stage 5 steps 136 Table ‎9-2: PRM artifact descriptions 138 Table ‎9-3: Main activities to build agency PRM 139 Table ‎9-4: Example measurement areas, categories and indicators 141 Table ‎9-5: BRM artifact descriptions 144 Table ‎9-6: Main activities to build agency BRM 145 Table ‎9-7: Example of business area, LoB, business function and sub-business functions 148 Table ‎9-8: ARM artifact descriptions 150 Table ‎9-9: Main activities to build agency ARM 153 Table ‎9-10: NEA ARM principles 154 Table ‎9-11: DRM artifact descriptions 158 Table ‎9-12: Main activities to build agency DRM 160 Table ‎9-13: Example data structure definition 163 Table ‎9-14: Example data exchange definition 163 Table ‎9-15: TRM artifact descriptions 165 Table ‎9-16: TRM service area and category descriptions 166 Table ‎9-17: Main activities to build agency TRM 167 Table ‎10-1: Stage 6 steps 175
  • 15.
    15 National Overall ReferenceArchitecture (NORA) – Handbook Table ‎10-2: Example of possible data sources 177 Table ‎10-3: BA relationship with other architectures 180 Table ‎10-4: BA artifact descriptions 182 Table ‎10-5: Activities to build BA 182 Table ‎10-6: The properties of organization chart 185 Table ‎10-7: Example of sub-business function description 189 Table ‎10-8: Business process description example 190 Table ‎10-9: Business activity description example 191 Table ‎10-10: The properties of service catalogue 193 Table ‎10-11: Service catalogue example 194 Table ‎10-12: AA relationship with other architectures 196 Table ‎10-13: AA artifact descriptions 198 Table ‎10-14: Activities to build AA 198 Table ‎10-15: The properties of application overview 199 Table ‎10-16: The properties of application catalogue 201 Table ‎10-17: Application catalogue example 202 Table ‎10-18: The properties of application function 203 Table ‎10-19: Application function example 204 Table ‎10-20: The properties of application relationship 206 Table ‎10-21: Application relationship example 207 Table ‎10-22: DA relationship with other architectures 209 Table ‎10-23: DA artifact descriptions 211 Table ‎10-24: Activities to build DA 211 Table ‎10-25: The properties of conceptual data model 212 Table ‎10-26: The properties of logical data model 213 Table ‎10-27: The properties of data flow diagram 215 Table ‎10-28: The properties of database portfolio catalogue 216 Table ‎10-29: Database catalogue example 217 Table ‎10-30: The properties of data dictionary 218 Table ‎10-31: Data dictionary example 219 Table ‎10-32: TA relationship with other architectures 221
  • 16.
    16 National Overall ReferenceArchitecture (NORA) – Handbook Table ‎10-33: TA artifact descriptions 223 Table ‎10-34: Activities to build TA 223 Table ‎10-35: The properties of infrastructure descriptions 226 Table ‎10-36: The properties of hardware catalogue 233 Table ‎10-37: Hardware catalogue example 234 Table ‎10-38: The properties of software catalogue 235 Table ‎10-39: Software catalogue example 236 Table ‎10-40: Activities to analyze current architectures 237 Table ‎11-1: Stage 7 steps 248 Table ‎11-2: Activities for defining target architecture directions 249 Table ‎11-3: Target BA artifact descriptions 252 Table ‎11-4: Activities to build target BA 253 Table ‎11-5: Target AA artifact descriptions 256 Table ‎11-6: Activities to build target AA 257 Table ‎11-7: Target DA artifact descriptions 260 Table ‎11-8: Activities to build target DA 261 Table ‎11-9: Target TA artifact descriptions 264 Table ‎11-10: Activities to build target TA 265 Table ‎12-1: Stage 8 steps 270 Table ‎12-2: Activities to define transition projects 270 Table ‎12-3: Activities to prioritize transition projects 272 Table ‎12-4: Activities to create transition roadmap 274 Table ‎12-5: Activities for estimating resources and outcomes 276 Table ‎13-1: Stage 9 steps 282 Table ‎13-2: Activities to define EA usage purpose & scope 283 Table ‎13-3: Activities to define usage plan development 285 Table ‎13-4: Example for EA users 286 Table ‎13-5: Activities of EA management purposes & scope 288 Table ‎13-6: Activities to develop EA management organization 191 Table ‎13-7: Activities to define EA management process 293 Table ‎13-8: Activities to define EA management system 297
  • 17.
    17 National Overall ReferenceArchitecture (NORA) – Handbook Table ‎13-9: Example for EA management system’s functions 298 Table ‎14-1: Stage 10 steps 301 Table ‎14-2: Example for EA management guideline 303 Table ‎14-3: Example for EA usage & management plan assessment 304 Table ‎14-4: Stage 1 summary 307 Table ‎14-5: Stage 1 steps 308 Table ‎14-6: Stage 2 summary 309 Table ‎14-7: Stage 2 steps 309 Table ‎14-8: Continuous governance summary 310 Table ‎14-9: Continuous governance steps 310 Table ‎14-10: Stage 3 summary 311 Table ‎14-11: Stage 3 steps 311 Table ‎14-12: Stage 4 summary 312 Table ‎14-13: Stage 4 steps 313 Table ‎14-14: Stage 5 summary 314 Table ‎14-15: Stage 5 steps 315 Table ‎14-16: Stage 6 summary 316 Table ‎14-17: Stage 6 steps 316 Table ‎14-18: Stage 7 summary 317 Table ‎14-19: Stage 7 steps 317 Table ‎14-20: Stage 8 summary 318 Table ‎14-21: Stage 8 steps 318 Table ‎14-22: Stage 9 summary 319 Table ‎14-23: Stage 9 steps 319 Table ‎14-24: Stage 10 summary 319 Table ‎14-25: Stage 10 steps 320 Table ‎14-26: NEA Meta-Classes 326 Table ‎14-27: NEA business service Meta-Class 335 Table ‎14-28: List of artifacts for e-Government Transformation Plan 343 Table ‎14-29: EA maturity components & levels 346 Table ‎14-30: Attributes of business service (Arabic & English) 348
  • 18.
    18 National Overall ReferenceArchitecture (NORA) – Handbook 1.Introduction
  • 19.
    19 National Overall ReferenceArchitecture (NORA) – Handbook 1. Introduction 1.1 Document purpose The purpose of this document is to describe and elaborate the National Overall Reference Architecture (NORA) that will be used as a guide for government agencies to develop their own Enterprise Architecture (EA). This document also describes, to some extent, how NORA is link to the overall National Enterprise Architecture (NEA) Framework. 1.2 National Enterprise Architecture Framework The National Enterprise Architecture (NEA) Framework is a key element for the national e-Government envisioned to incorporate a federate approach to enterprise architecture for the Kingdom of Saudi Arabia (KSA). NEA Framework supports the identification of re-usable components and services, and facilitates a basis for Information Technology (IT) investment optimization. In addition, NEA enables more cost-effective and timely delivery of e-services through a repository of standards, principles and reference models that assist in the design and delivery of business services to citizens, residents, commercial establishments and inter-government collaboration. 1.3 Values of NORA Government agencies who do not have an EA in practice would typically face the following problems: 1. Lack of standardization of business services, data and IT interoperability within the government agency and across government agencies 2. Lack of performance indicator in IT investment linking to the business objectives 3. Government business ownerships are unclear 4. Lack of whole of government agency view 5. Duplicated IT systems, data and IT infrastructure within a government agency is common 6. Misalignment between government agency’s business services and IT initiatives 7. Lack of standards to integrate services, business processes, IT systems, data and IT infrastructure 8. No performance indicators for business function and services 9. Lack of quality checks for delivering IT systems, data and infrastructure
  • 20.
    20 National Overall ReferenceArchitecture (NORA) – Handbook 10. Lack of integrated government services and consistent delivery. 11. With EA, the above problems can be eradicated. However, the development and implementation of an EA is not an easy task and government agencies can face the following challenges: 12. EA stakeholders’ low awareness on EA, its benefits and its practices 13. Little knowledge of EA building process 14. Communication barriers and bottlenecks among EA stakeholders 15. Implementing EA without a systematic approach 16. Experiencing difficulty in maintaining EA practices 17. Excessive reliance on vendors and external expertise. 1.4 Goals of NORA The goals of NORA are as follows: 1. Define scope and requirements of the EA at the government agencies 2. Help government agencies to have a smooth and effective EA implementation 3. Ensure quality of government agency’s EA through systematic processes and recommendations 4. Alignment of agency’s EA with Saudi government national architecture and National Action Plans to facilitate whole of government approach 5. Facilitate EA utilization, promotion and capability building in the government agencies.
  • 21.
    21 National Overall ReferenceArchitecture (NORA) – Handbook 1.5 Features of NORA The main features of NORA are: 1. As a guide for EA development, it is written from the government agencies’ perspective 2. All stages in the EA lifecycle are described to some detail to provide clarity to the government agencies 3. Balanced approach in EA development that focuses both on processes and the production of standard artifacts or deliverables 4. Examples and example outputs are provided to aid understanding 5. Highly customizable to suit varied requirements of different government agencies. 1.6 Target audience As NORA is a guide for government agencies to develop their EAs, the target audience for NORA are as follows: 1. Enterprise Architects 2. Business Architects 3. Application Architects 4. Data Architects 5. Technology Architects 6. IT Architects 7. CIOs 8. CXOs 9. Project Managers 10. Business Owners 11. IT System Owners 12. IT Managers 13. Project Managers 14. IT Consultants 15. IT Vendors.
  • 22.
    22 National Overall ReferenceArchitecture (NORA) – Handbook 1.7 Document structure NORA contains the following sections: 1. Executive Summary 2. The executive summary gives a complete summary of NORA. After reading this section, the reader can understand how NORA guides the government agencies in the EA development. The executive summary is excellent for government agencies’ decision makers. All staff involve in EA should also read this executive summary. 3. Stages of EA Development 4. This document provides the detailed description by stages. The detailed process and expected EA deliverables are explain in each stage. Examples and templates are also provided where possible. 5. Annex The annexes provide additional templates, checklists and information. 1.8 Related information As NORA is only one of the many documents, it is advisable to refer to the main NEA Framework. 1.9 Contact information For any feedback, comments or need for more information on NORA, please email to nea@yesser.gov.sa
  • 23.
    23 National Overall ReferenceArchitecture (NORA) – Handbook 2.Executive Summary
  • 24.
    24 National Overall ReferenceArchitecture (NORA) – Handbook 2. Executive Summary 2.1 Need for Enterprise Architecture Gartner Research defines enterprise architecture as: “Enterprise Architecture (EA) is a discipline for proactively and holistically leading enterprise (i.e. government) responses to disruptive forces by identifying and analyzing the execution of change toward desired business vision and outcomes. EA delivers value by presenting business and IT leaders with signature-ready recommendations for adjusting policies and projects to achieve target business outcomes that capitalize on relevant business disruptions.” Government agencies have to respond to continuous disruptive forces such as economic changes, social demands, political directions and technology advancements. The government agencies’ responses to these disruptive forces are on their own silo actions. While government agencies have made their best effort to derive their own desired outcomes, the end result to the stakeholders such as citizens, businesses and government leaders are far from real satisfaction. With EA, on the other hand, the execution of change is a structured approach with the various perspectives on the government business, desired outcomes, availability of technologies and processes. When EA is correctly implemented, it provides the following valuable benefits to key decision makers: • Insight – the abstraction of knowledge based on detailed information including issues, challenges and opportunities • Oversight – the information overview corresponding to the overall accountabilities and responsibilities of the government agencies, and for the whole-of-government • Foresight – from the analysis of detailed data from various sources, trend analysis and event probabilities can be calculated and estimated.
  • 25.
    25 National Overall ReferenceArchitecture (NORA) – Handbook The diagram below shows the typical situation of government agencies without EA and the benefits with EA. Figure ‎2-1: Impact of EA on government
  • 26.
    26 National Overall ReferenceArchitecture (NORA) – Handbook 2.2 Background of NEA Framework The NEA Framework is the window for strategic integration and collaboration of an effective na- tional e-government implementation. NEA is the enterprise architecture for the whole-of-Saudi government. Together with other strategies such as the Saudi e-Government Action Plan, the NEA Framework and its components allow useful insight and foresight for the future development and implementation of highly integrated e-government and e-services. The NEA Framework has 11 main architecture components as depicted in the diagram below. Each architecture component has a specific role and function. In addition, each architecture component may have direct or indirect relationship(s) with other architecture components. The table below provides a summary list of all the 11 architecture components. Please refer to separate documents for detailed information of the architecture components. Figure ‎2-2: NEA Framework
  • 27.
    27 National Overall ReferenceArchitecture (NORA) – Handbook Compo- nent Name Component Description Strategy The strategy component of NEA Framework captures the essences of strategic alignment with National and e-government strategic plans. The constituents of the strategic component takes cognizance of the envisioned future as per the above plans, and aligns itself strategically by producing long term and short term plans to meet that future vision. The Journey being guided by adequate policies. Models The NEA Models are a high-level classification of views , key architectural elements and the best practice for them. They facilitate in forming standardized viewpoints for example from a snapshot of the whole of government to Performance, Business, Application, Data, Technology, Security, Maturity etc.. Operation The operation is about managing the day to day business of NEA, that primarily involves designing, and controlling the process of service delivery and redesigning business operations in delivering services. It is guided by well-defined processes, methodology and tools that ensure business operations are efficient and effective in terms of meeting customer requirements. Governance NEA governance is about providing the strategic directions to achieve the NEA vision, mission and objectives through agile organization structure, clear roles and responsibilities, and effective set of governance or management practices. It is also about regular monitoring and reviewing of progress while understanding the constant changes in economic, social and technological environments Table ‎2-1: List of NEA Framework Components NORA is one of the integral parts of NEA Framework. NORA’s role within the NEA Framework is to provide a definitive and clear methodology for building EA in the government agencies.
  • 28.
    28 National Overall ReferenceArchitecture (NORA) – Handbook 2.3 Objectives of NORA The objectives of NORA are as follows: 1. To guide government agencies in their development of EAs 2. To speed up EA development with quality outputs 3. To ensure EA in government agencies are aligned with their e-Government transformation and IT plans. 2.4 Defining a purpose for agency EA In alignment to the strategic 2nd Saudi e-Government Action Plan, every government agency is expected to have an e-transformation roadmap that would pave the way for advancement of delivering government services. EA is an excellent tool for planning as well as implementing this e-transformation roadmap. Although the ultimate goal is to transform their government services and business functions, government agencies have to find and determine the most important driver or motivation to develop their very own EA. The following table lists the common drivers and the corresponding objectives to develop EA. These common scenarios will influence the use of NORA as a guideline to develop EA for agencies.
  • 29.
    29 National Overall ReferenceArchitecture (NORA) – Handbook Drivers EA Objectives - Values Lack of governance and prioritization Comprehensive understanding of agency-wide perspective, including its problems, challenges, investments and opportunities Lack of agency wide information IT standardization, with detail information and inter-relationships between business and technologies No integration among departments No duplication of investments and systems; integration of work resulting in efficiency and better customer service Duplicated investments Prevent investments and work duplication Ineffectiveness and inefficiency in public service delivery Understand agency weaknesses; integrated approach to improve agency’s productivity and public service delivery No standard operations Implement quality business and service operations No technology standards Interoperability of systems and processes in the agency Investing capital and procurement costs Effective investments that align business and IT Table ‎2-1: Common EA objectives / drivers While government agencies may have different motivations, there are also common purposes shared among all government agencies. The following are the top reasons for embarking on EA journey: 1. Implementing e-Government transformation roadmap 2. Optimizing IT investments 3. Reducing IT costs 4. Aligning IT to government business. As EA is a wide program with an on-going or continuous journey, it is possible that government agencies will require specific purposes, over time, to review and improve their EAs such as the following examples:
  • 30.
    30 National Overall ReferenceArchitecture (NORA) – Handbook Standardization and interoperability of services, IT applications, data and infrastructure Selection and/or prioritization of projects in the government agency for funding and implementation 1. Building new capability such as improving customer service, making business processes effective, and agency-wide adoption of mobile applications and devices 2. Improve and integrate business critical government services and business functions through Business Process Re-Engineering and automation 3. Development of IT Resource Management and IT Portfolio Management. 2.5 NORA methodology NORA methodology is based on a lifecycle consisting of ten major stages. The execution of the stages are in sequence, however it can be tailored to suit the purpose of agency EA. Each stage has its own architecture artifacts or deliverables. In NORA, a continuous set of governance activities are carried out throughout the nine stages. Figure 2-3 below illustrates the NORA Methodology. Continuous Governance (applicable during all stages) As EA is a massive and long-term project, there are bound to be many challenges and issues. It is vital, therefore, that the EA governance work is also address to ensure the success of the project. The EA governance is continuous - covering activities such as program management, change management (including EA awareness and promotion), capability management (specific trainings, tools and new processes), performance management (new KPIs and standards) and policy management. Stage 1 – Develop EA Project Strategy This stage describes the key activities to research, plan and obtain approval to embark on the EA project. Each government agency has to obtain its project funding and to either develop its EA internally or outsource.
  • 31.
    31 National Overall ReferenceArchitecture (NORA) – Handbook Stage 2 – Develop EA Project Plan Having established an approved EA Project Strategy, the government agency has to carry out the detailed plan for the EA project. This stage describes the key activities involved in developing and obtaining approval for the EA project. Stage 3 – Analyze Current State With the approved EA project plan in place, the government agency can start the actual work by analyzing its current state – both in terms of business and IT. This stage describes the key activities in reviewing and analyzing the different aspects of the current state of the government agency. Stage 4 – Develop EA Framework This is the stage where a government agency starts to develop its EA. In this stage, the government agency constructs the main pillars such as EA vision & mission, architecture goals & principles, EA Framework, taxonomy, and other related standards that is fundamental to its EA journey. The government agency should focus on building quality EA framework and other relevant processes. Stage 5 – Build Reference Models Based on the EA framework developed previously, this stage is all about building the reference models so that a government agency can have standard views and taxonomies of key organizational assets and processes such as business, application, data and technology domains. Stage 6 – Build Current Architectures The focus of this stage is in capturing the current architectures of the government agency so that the agency can clearly understand its IT and business landscapes. This would allow a better visibility of the interconnections among different architectures and components, and aid in analyzing the agency’s issues, challenges and opportunities relating to business, information/ data and technologies.
  • 32.
    32 National Overall ReferenceArchitecture (NORA) – Handbook Stage 7 – Build Target Architectures With the completion of the government agency’s current architectures, this stage develops the target architectures. As a blueprint for the government agency to realize its goals and desired out- comes in 3 to 5 years, the target architecture defines the improved business and IT landscapes. Stage 8 – Develop Transition Plan With the completion of the various target architectures in the previous stage, it is now impor- tant to plan and manage the transition required from the current landscapes to the desired target landscapes. Stage 9 – Develop EA Management Plans This stage is about developing the EA usage and management plans so that EA processes and values become an integral part of the agency standard operating procedures. To ensure contin- ued EA value delivery to the government agency, it is necessary and important to incorporate EA management plans into the government agency. Stage 10 – Execute & Maintain This is the last stage where a government agency executes and maintains its EA. Having covered many stages in the EA journey, this last stage concerns with taking actions to make the govern- ment agency’s EA into a reality.
  • 33.
    33 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎2-3: NORA Methodology Please also refer to Annex A – Summary of NORA Deliverables by Stages that acts as a checklist for government agencies in their EA development.
  • 34.
    34 National Overall ReferenceArchitecture (NORA) – Handbook 2.6 NORA relationship to NEA Framework Although NORA is only a guide for government agencies to develop their EAs, it is nonetheless an important methodology. When government agencies develop their EAs according to NORA, not only do they deliver their own EAs, but also it ensures that all EA development complies with the overall NEA Framework. NORA allows government agencies to comply with and align to the national e-Government transformation plan and initiatives. Through NORA, government agencies can review and develop detailed reference models – each aligned with the NEA Framework’s reference models such as Business Reference Model, Application Reference Model, Data Reference Model and Technology Reference Model. When the various reference models are aligned, it aids government agencies to share applications and information, and to develop highly integrated business functions and services that delight citizens and businesses.
  • 35.
    35 National Overall ReferenceArchitecture (NORA) – Handbook 3.Stage1-Develop EAProjectStrategy
  • 36.
    36 National Overall ReferenceArchitecture (NORA) – Handbook 3. Stage 1 - Develop EA Project Strategy 3.1 Stage summary This stage describes the key activities to research, plan and obtain approval to embark on the EA project. Each government agency has to obtain its project funding and to either develop its EA internally or outsource. 3.2 Stage purpose Lay the foundation of a government agency’s EA implementation journey with clear directions and commitments. The following specific expected outcomes from this stage are: 1. Increase the government agency’s EA awareness – from top management to the operations staff 2. Define and communicate EA goals and directions 3. Obtain management approval to embark on the EA journey. 3.3 Stage initiation Yesser will communicate with the e-Transformation Committee in each government agency to initiate the agency EA implementation. Government agencies can also request and discuss with Yesser to initiate their EA program. 3.4 Key steps in stage 1 Preparation is an important stage that requires diligent research and planning. This is the first major step to embark EA in the government agency. The key activities and expected deliver- ables in Stage 1 are shown in Table 3-1:
  • 37.
    37 National Overall ReferenceArchitecture (NORA) – Handbook Stage / Step No Description Deliverable 1 Develop EA Project Strategy Government Agency’s EA Project Strategy 1.1 Analyze EA trends and case studies (both international and local agencies; also across same line of business/Business function in BRM ) Document relevant EA trends and case studies relating to the government agency 1.2 Provide EA awareness to government agency’s business and IT leaders (Government agencies can invite Yesser to brief on NEA) Understand the importance of EA 1.3 Assess government agency’s e-transformation maturity(Via Qiyas) and its alignment of IT to the government business Submit and present the assessment report to the e-Transformation Committee or equivalent. The assessment shall describe the agency’s: 1. Maturity of its e-transformation 2. Effectiveness of its business functions 3. Maturity on IT adoption 4. Agency’s capability on business productivity and use of IT. 1.4 Document government agency’s EA project strategy Draft Government Agency’s EA Project Strategy 1.5 Present and obtain approval for the EA project strategy Approved Government Agency’s EA Project Strategy by its e-Transformation Committee or equivalent Table ‎31: Stage 1 steps
  • 38.
    38 National Overall ReferenceArchitecture (NORA) – Handbook 3.4.1 Step 1.1 Analyze EA trends and case studies As stated by International Benchmarking Clearinghouse (IBC), analyzing EA trends is a set of “Activities to continuously evaluate and compare world’s leading corporations or agencies with a current organization to improve the organization’s performance”. This activity is vital for the agency implementing EA, in terms of understanding the best practices adopted by similar verticals. To leverage their learning, choose the most applicable strategy for the agency. However if the agency finds itself in a difficult position either to execute it, or if there is a possibility of this effort forking into a new project and hence impede the EA strategy development. Then, they may choose to limit the scope of the activity to reduce negative impact on the EA Project. While there are numerous ways to carry out this step, the following activities are recommended: 1. Form a small team of members (both IT and non-IT) who are interested and passionate about EA 2. Understand the basics of EA by attending seminars or trainings 3. Carry out a high level research on the current trends in EA. Examples of reliable online resources include Federal Enterprise Architecture (FEA), The Open Group Architecture Framework (TOGAF), National Association of State Chief Information Officers (NASCIO) and Enterprise Architecture Center of Excellence (EACOE). There are also numerous articles on ‘EA Trends in Government’ (simply search on the Internet for the latest) 4. Refer to more detailed EA case studies for similar line of business or government domain such as Education, Health, Agriculture, Oil & Gas (Energy) and Municipality 5. Document the findings and find basic patterns in EA development 6. Refer to the Yesser’s National Enterprise Architecture (NEA) Framework. They can also discuss with Yesser’s NEA Office for details and to find other relevant government agencies who have embarked or completed their EAs 7. Finalize the EA analysis document.
  • 39.
    39 National Overall ReferenceArchitecture (NORA) – Handbook 3.4.2 Step 1.2 Provide EA awareness Having documented the EA trends and case studies that are relevant to the government agency, the next step is to spread the importance of EA. The idea is to provide constant awareness to all levels of staff in the government agency – both the business and IT staff, including top management and the operations staff. In particular, provide the EA awareness to the top management or e-Transformation Committee. This is important as they will be the main decision makers and sponsor for the EA project. Government agency can also work with Yesser to present EA as a strategic enabler in e-Government to them. The recommended EA value propositions are listed in Table 3-2: S/No Stakeholder EA Value Proposition 1 Top Management (Minister, Di- rector-General, CEO, CXO) and / or e-Transformation Committee 1. Align government agency projects with Vision 2030, National Transformation Plan and Saudi e-Government Action Plan 2. Aid planning and prioritizing government agency-wide action plan 3. Improve service quality to citizens and businesses 4. Prioritize and improve IT investments for government agency 5. Business and technology innovation to deliver highly integrated, value-added services. 2 Finance Director / CFO 1. Reduce wastage of IT costs 2. Prioritize and improve IT investments for government agency. 3 Business Owners 1. Improve service quality to citizens and businesses 2. Increase productivity 3. Integrate work across business domains or divisions, including inter-agency. 4 IT Director / CIO 1. Prioritize IT projects 2. Reduce wastage of IT costs 3. Identify consolidation projects to reduce IT cost and better management 4. Develop inter-operability standards within govern- ment agency and inter-agency. Table ‎32: EA value proposition to stakeholders
  • 40.
    40 National Overall ReferenceArchitecture (NORA) – Handbook In addition to the EA Value Proposition, the team can also provide EA awareness on factors such as: a. Explain best EA practices in other agencies. b. Explain EA related laws and regulations imposed on government agencies via decrees . c. Explain how EA affects agency’s performance and innovation endeavors, and what EA will bring to the agency’s executives. d. Utilize external expertise as needed. It is recommended that the team present the EA value proposition to the IT Director or CIO first. Subsequently, the team can present or provide awareness to the different stakeholders and obtain feedback from them. Finally, they can present to the top management to get their buy-in. The government agency can also approach Yesser’s NEA office to help in the EA awareness sessions. For now, the awareness sessions are to make the stakeholders think about the value of EA. It is not to get their approval yet (although it would be good). Once they are aware of the benefits of EA, the team may also need to engage them for the next step. Note that these awareness sessions are part of the continuous EA governance (see the ‘Continuous Governance’ section for details). 3.4.3 Step 1.3 Assess government agency’s e-transformation maturity This step focuses on the maturity of the government agency’s e-transformation. From the above value propositions, EA can help to determine areas for improvements to increase the e-transformation maturity. The e-Transformation maturity is measured yearly by Yesser using the Qiyas tool. The outcome of this step will drive the actual scope and motivation for the government agency’s EA. The following activities are recommended:
  • 41.
    41 National Overall ReferenceArchitecture (NORA) – Handbook 1. Obtain the government agency’s maturity report from Yesser via Qiyas 2. Factors for consideration include rate of IT adoption, effectiveness of business services & functions, satisfaction level of citizens & businesses, rate of alignment with 2nd Saudi e-Government Action Plan, government agency’s capability on business productivity, and the extent of sharing of applications, data and IT infrastructure within the government agency and inter-agency 3. Identify the areas for improvements 4. Analyze these areas and map to the specific EA value propositions 5. Also refer to NEA Maturity Model so that the government agency can further assess its maturity 6. Shortlist the recommended EA value proposition(s) 7. Present to the e-Transformation Committee or equivalent and get their approval or concurrence. From their feedback, may need to do changes to finalize the EA value proposition. Table 3-3 provides a summary of the likely EA value propositions based on the e-transformation maturity level. Note that this is only an indication. Government agencies have to do their own detailed analysis.
  • 42.
    42 National Overall ReferenceArchitecture (NORA) – Handbook S/No e-Transformation Maturity Likely EA Value Proposition(s) 1 LOW a. Align government agency projects with Saudi e-Government Action Plan b. Aid planning and prioritizing government agency-wide action plan c. Improve service quality to citizens and businesses Prioritize IT projects 2 MEDIUM a. Align government agency projects with Saudi e-Government Action Plan b. Aid planning and prioritizing government agency-wide action plan c. Improve service quality to citizens and businesses d. Increase productivity e. Prioritize and improve IT investments for government agency f. Reduce wastage of IT costs g. Identify consolidation projects to reduce IT cost and better management h. Develop inter-operability standards within government agency and inter-agency 3 HIGH a. Prioritize and improve both business and IT investments for government agency b. Business and technology innovation to deliver highly integrated, value-added services c. Significant performance improvements for the government agency Table ‎3-3: Likely EA value proposition based on e-Transformation maturity
  • 43.
    43 National Overall ReferenceArchitecture (NORA) – Handbook Below are examples of local government agencies’ EA drivers – i.e. the motivation reasons or purposes in developing their own EAs. Government Agency EA drivers The National Information Center (Technology arm of Ministry of Interior) 1. Lack of agency-wide view to govern projects (both business & IT) and resources 2. Duplicated investments especially in IT 3. Inefficient and ineffective in delivering quality and timely government services 4. Operational difficulties due to abundance of non- standardized infrastructure and technologies The National Center for Education Information (Ministry of Education) 1. Lack of agency-wide view to govern projects (both business & IT) and resources 2. Duplicated investments especially in IT 3. High demand for IT services and solutions 4. Complex business and IT landscapes 5. Organizational difficulties such as ineffective communications, lack of transparency and inefficiency Ministry of Education (Higher Education) – Safeer Program 1. No organizational-wide view of services, applications, business processes, data and IT infrastructure that affect strategic decision making 2. High IT operational costs 3. Operational complexity National Center for Assessment in Higher Education (Qiyas) 1. Lack of organizational-wide governance 2. Not business-driven; instead IT-led 3. Improve the delivery of quality services 4. Operational complexity & high costs 5. Performance limitations Table ‎3-4: Local examples for EA drivers or purposes
  • 44.
    44 National Overall ReferenceArchitecture (NORA) – Handbook 3.4.4 Step 1.4 Document government agency’s EA project strategy After some EA awareness sessions and followed by the approval from the top management or e-Transformation Committee, there should be sufficient driving factors by now to embark on the EA development. It is vital, however, to document an EA Project Strategy clearly describing the goals, expected outcomes, and project schedule with a list of resources required. The EA Project Strategy should focus on strategic and long-term outcomes for the government agency. In the next step, a more detailed EA Project Plan will be created. For this step, the EA Project Strategy should cover the following topics: 1. The EA Value Propositions or Purposes 2. Goals or Objectives of the EA Project 3. Scope and Schedule of the EA Project 4. EA Development Considerations and Approach (including phase/gradual development strategy and sourcing method i.e. In-House or Out-Source) 5. Estimated Cost and Resources (Staff) Requirements. Table 3-4 illustrates the key considerations in developing the EA Project Strategy.
  • 45.
    45 National Overall ReferenceArchitecture (NORA) – Handbook Considerations Pros Cons Scope Gradual Stable EA management with minimized risks Losing momentum due to extended development period All at once Outcome in organization’s overall perspective. Risk of failure depending on organization’s readiness Workforce In-House Internal resource can be utilized Extended preparation time Outsourcing Timely staffing of expertise desired Little knowledge accumulation. Excessive reliance on outer resources. Direction Upward Visible outcomes on time Extra efforts on integration/ alignment needed Downward Realizing EA’s full po- tential Extended time to see visible outcomes Focus All Even An overall architecture can be obtained Additional time and cost. Missing in-depth information on critical areas Focus on Key Areas Visible outcome in major areas. Momentum when expanding areas Difficulty of use due to uneven depth of information Table ‎3-5: Considerations for EA project strategy development Depending on the EA value proposition or purpose, the EA strategy is typically build gradually over time from bottom-up, top-down, or both. The following are examples of EA development strategies.
  • 46.
    46 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎31: Example of bottom-up development strategy Figure ‎32: Example of mixed development approach 3.4.5 Step 1.5 Present and obtain approval for EA project strategy Present and get approval on the EA Project Strategy from the e-Transformation Committee or equivalent. Note that this is not an easy task and may need a few iterations. The recommended activities are: 1. From the awareness sessions, the team can have a good idea who can provide good direc- tions, requirements and supportive of the EA project. Thus, obtain feedback on the EA project strategy from these key stakeholders 2. In addition to the EA project strategy documentation, prepare a precise yet effective pre- sentation slides 3. Present to the key stakeholders and other EA supporters. From their feedback, update the presentation slides and EA project strategy document respectively 4. Finally, present the e-Transformation Committee or equivalent for approval.
  • 47.
    47 National Overall ReferenceArchitecture (NORA) – Handbook 4.Stage2-Develop EAProjectPlan
  • 48.
    48 National Overall ReferenceArchitecture (NORA) – Handbook 4. Stage 2 - Develop EA Project Plan 4.1 Stage summary Having established an approved EA Project Strategy, the government agency has to carry out the detailed plan for the EA project. This stage describes the key activities involved in developing and obtaining approval for the EA project. 4.2 Stage purpose The government agency has to structure and form appropriate EA Core team(s) and develop the detailed EA project plan. The following specific expected outcomes from this stage are: 1. Clarify roles and responsibilities of management and the various working teams 2. Clarify the governance and management of EA in the government agency 3. Obtain management approval and commitment on the goals, schedules and resources to develop and implement the EA. 4.3 Stage initiation This stage begins with the endorsement or approval of the EA Project Strategy in Stage 1. 4.4 Key steps in stage 2 Table 4-1 lists the key steps in Stage 2.
  • 49.
    49 National Overall ReferenceArchitecture (NORA) – Handbook Stage / Step No Description Deliverable 2 Develop EA Project Plan Government Agency’s EA Project Plan 2.1 Upon approval of the Project Strategy (Step 1.4), propose and set up the vari- ous EA committees and teams such as EA Governance Committee, EA Working Team, Business-Domain Working Team and the IT Working Team. Approved EA committees and working teams by the e-Transformation Committee or equivalent 2.2 Finalize the EA development approach such as scope, budget, schedule, and including outsourcing or insourcing of the Government Agency’s EA implementation. Also include the adoption of EA culture into all aspects of business and IT planning and reviews Approved EA development approach by e-transformation committee or equivalent 2.3 Upon approval of Steps 2.1 & 2.2, the EA working team will document the detailed EA Project Plan Draft EA project plan 2.4 Present and obtain approval for the EA project plan Approved EA project plan by the EA Governance Committee Table ‎4-1: Stage 2 steps 4.4.1 Step 2.1 Set up EA committees and working teams The first activity is to set up the necessary committees and working teams. Depending on the government agency’s EA goals and scope, the type of committees and working teams may vary. Although every government agency has an e-Transformation Committee that oversees the overall development and progress of the e-Government transformation, there is a need for an EA governance committee to oversee and direct the progress of the EA development project. EA is one of the main enablers for an effective e-Government transformation. Typically, one of the e-transformation committee members (i.e. the main EA sponsor) will chair the EA governance committee. Table 4-2 lists the common committees and working teams for a government EA development project, while Figure 4-1 shows a example EA organizational structure. Note that these are only recommendations. Government agencies have to find the best organizational structure for its EA project.
  • 50.
    50 National Overall ReferenceArchitecture (NORA) – Handbook S/No Name of Committee / Working Team Responsibilities Members 1 EA Governance Committee a. Steers and provides strategic government agency-wide directions b. Empowers the working teams with account- abilities and resources c. Makes strategic decisions on EA recommen- dations that affect the whole-of-govern- ment agency (including its branches if any) d. Raise up matters or issues affecting govern- ment agency-wide and inter-agency col- laborations e. Reviews and endorses the EA Project plans, frameworks and reference models f. Reviews and approves strategic policies and actions as recommended by the EA Core Team. The government agency e-Transformation Committee (if exist) can also play another role as the EA Governance Committee. Alternatively, the members recommended are: i. Deputy Under Secretary / Deputy CEO / Deputy DG as Chairperson (basically the 2nd highest person in the government agency) ii. CxO(s) iii. CIO / IT Director iv. Chief Architect (could be an outsourced role) v. Directors of core business functions. 2 EA Core Team a. Architects the government agency’s EA b. Develops EA framework and reference mod- els c. Recommends strategic directions, policies and projects for the whole-of-government agency. i. Chief Architect ii. Business Architect iii. Application Architect iv. Data Architect v. Technology Architect vi. EA Working Team members (see below). 3 EA Working Team a. Develops the various EA Reference Models and Standards b Maintains the EA artifacts c. Provides trainings and awareness to the government agency. i. Business domain experts in+the core government agency’s functions ii. IT Manager iii. IT engineer who is in charge of infra- structure and technology matters iv. Database Administrator (DBA) v. Application Analyst. Table ‎4-2: Typical government EA committees and working teams
  • 51.
    51 National Overall ReferenceArchitecture (NORA) – Handbook Some important notes: 1. EA project is not only about IT. Hence, it is important that sufficient staff from the business do- mains are involved. The business domains experts should be experienced and have good detailed knowledge about the government agency’s main businesses. 2. It is also recommended to get the business experts who are in charge of the core e-services and customer/citizen service relationship (if any) 3. As for the IT staff members, they should be experienced and are leading specific teams such as infrastructure, database and applications. Figure 4-1 illustrates an example of the EA organizational structure. Figure ‎4-1: Example of EA organizational structure
  • 52.
    52 National Overall ReferenceArchitecture (NORA) – Handbook In addition to the organizational structure of the committees and working teams, it is also a necessity to define basic governance or management processes relating to the approval of projects and activities. The tables below provide different governance/management areas for considerations and example cases use in government agencies respectively. For more details on governance, please refer to the section “Continuous Governance”, Management Field Key Content Program Management 1. Track the progress of the EA project 2. Provide updates to the EA Governance Committee 3. Highlight or alert issues pertaining to schedule, resources and budget. Change Management 1. Ensure quality of content in the EA deliverables and artifacts 2. Control and approve changes and publishing of artifacts 3. Agree on removal or deletion of obsolete artifacts. Performance Management 1. Analyze and review impact of EA on the government agency 2. Measure the usefulness of EA in different aspects and operations of the government agency 3. Approve the areas of improvement as described in the EA’s recommendations. Capability Management 1. Identify skills for development in the government agency 2. Identify departments, division or business functions that require increased or improved capabilities 3. Approve on training programs and incentives. Table ‎4-3: Governance / Management fields
  • 53.
    53 National Overall ReferenceArchitecture (NORA) – Handbook Government Agency Management Scope The Ministry of AAA • EA progress management group • EA progress management procedure - Progress management procedure, change request · re- view, decision-making on changes, EA synchronization, EA re-composition, EA release The Ministry of BBB • EA management group • EA work planning - EA project planning, EA observance, EA change, EA use sup- port, EA system operation, EA assessment • Management support tool - management guideline, training planning, change manage- ment, transition plan, performance model The Ministry of CCC • EA management group plan • EA management process • EA maturity model • EA management guideline Table ‎4-4: Examples of governance / management fields in government agencies These recommendations on committees / working teams and governance processes have to be approved by the e-Transformation Committee or equivalent. On approval, these committees and working teams can officially embark on the detailed EA development work. Please refer to the ‘Continuous Governance’ section for more details.
  • 54.
    54 National Overall ReferenceArchitecture (NORA) – Handbook 4.4.2 Step 2.2 Finalize EA development approach The result of Stage 1 was the high-level EA Project Strategy developed by a small group of individuals. As EA is a wide topic with many factors, it is a prudent approach to develop a more detailed EA Project Plan with inputs from various perspectives within the government agency. With the setup of the various EA committees and working teams, the official EA work can begin. The EA Core Team and the various working teams can meet, discuss and finalize on the following: 1. EA Objectives / Goals Agree on the primary objectives or goals of the EA project. The initial objectives or goals defined in the EA Project Strategy have to be reviewed and discussed with the new members in the EA Core Team and working teams. It is common that the EA objectives or goals are and/or amended. 2. EA Scope The EA Core Team and working team members need to have detailed discussion on what entails the EA development scope for the government agency. The EA scope will affect the resources required, time and budget. With inputs from different members, there is a tendency that the scope can be specific. The government agency also has to consider a gradual or consolidated scoping i.e. to do everything in the EA at once or to build the EA gradually over time. The EA Core Team or Chief Architect has to normalize or find a balance in the EA scoping. Below are some examples of the EA scopes.
  • 55.
    55 National Overall ReferenceArchitecture (NORA) – Handbook Item Specific Scope Current / Target Architecture 1. What was the primary Purpose for developing EA? 2. Is the primary purpose to develop future business and IT blueprints? 3. Is the primary purpose to manage effectively the current IT resources? Architecture Scope and Level 1. An agency with no EA experience would better off with a gradual approach. 2. The T-approach (overall architecting + in-depth architecting on cer- tain areas) can be taken as needed. 3. Gradual scoping appropriate to EA purposes 4. A current architecture should be detailed enough to perform an overall analysis. Target architecture should be drawn at the planner level and contain details down to the developer level. Business / Application / Data / Technology / Security 1. Is business process improvements? 2. Is there a need to align IT projects with the business objectives? 3. Is a data renovation such as data standardization or data sharing urgent? 4. Is there an urgent need for IT standardization or IT asset management? Table ‎4-5: Examples of EA scope
  • 56.
    56 National Overall ReferenceArchitecture (NORA) – Handbook Gradual Scoping Examples 1 a. On some domains (Strategy, Business, IT etc.) b. Vision / Principles, Framework, Reference Models c. Current and Target Architecture d. Transition Plan e. Training / Promotion 2 a. On all domains b. Current and Target Architecture c. Transition Plan e. EA Tool f. Training/Promotion g. EA Maturity Level Assessment 3 a. EA Use and Management Plan b. Guideline Revision c. Reinforce EA Environment d. Training/Promotion e. EA Expertise (Internal Architects) Table ‎4-6: Examples of EA gradual scoping 3. Development Approach In Stage 1, the EA Strategy has probably described the development strategy. This is typically a phased approach such as bottom-up, top-down or mixed. In this stage, the EA Core Team and other development teams have to review and further discuss the best approach taking into consideration the changes made to the EA scope. Depending on the actual EA value proposition or purposes, the following are recommended:
  • 57.
    57 National Overall ReferenceArchitecture (NORA) – Handbook S/No EA Objectives / Values Strategy 1 Understanding agency-wide perspective on issues, problems, challenges, etc. Carry out both business and IT landscape studies. This in- formation are valuable for both business and IT planning activities, and they are pre-amble to the EA activities. 2 IT Standardization especially for infrastructure, databases and applications Develop the technology Architecture including IT stan- dards and guidelines as the first major EA deliverable. 3 Tuning and Consolidation of IT Infrastructure Develop the Technology Architecture including IT stan- dards and guidelines as the first major EA deliverable. In particular, architect for shared and consolidated IT infra- structure environment. Use Return-on-Investment (ROI) as a financial justification for the consolidation exercise. 4 Consolidating data elements and data exchange Develop the Data / Information Architecture as the main deliverable. However, need physical solution such as net- work, databases, storages, etc. Recommended to next develop the Technology Architecture and then implement the data consolidation exercise. 5 Application consolidation Develop the Application Architecture. However, need physical solution such as servers, databases, storages, etc. Recommended to next develop the Technology Ar- chitecture and then implement the application consoli- dation exercise. 6 Business and service improve- ment, delivery First, develop the Business Architecture. Document all the key business processes and services. Develop a methodology to select business processes and services for improvements. Recommended to develop the Appli- cation or Technology Architecture subsequently. 7 Reviewing and improving major program Ensure that the program scope is clear. Recommended to develop the Business Architecture first. The other IT- related Application, Data and Technology architectures can start in parallel. 8 Business and IT Alignment and Investment Recommended to first develop the Technology Ar- chitecture. Next, develop the Business Architecture. If possible, also develop the Application Architecture (but if this is not possible due to time, then simply lists the entire application inventory to establish the busi- ness function and application relationship). Carry out a gap analysis study and provide recommendations for improvements. Table ‎4-7: Development approach recommendations
  • 58.
    58 National Overall ReferenceArchitecture (NORA) – Handbook 4. Budget Review, analyze and re-estimate the initial budget from Stage 1. The EA scope affects the overall development budget. Time and money need to be budgeted properly, since EA practice is ongoing and variable. Update the EA budget taking the following information for consideration. Budget Category Budget Description EA Development Budget 1. EA development scope Current Architecture, Target Architecture development scope Entire/Partial, Organizations/Projects Business/ Application/Data/Technology/Security Reference model development scope 2. EA tool cost, Software/Hardware cost (It’s possible to do step-by-step planning and budgeting for the EA development, EA Tool) EA Management Budget 1. EA management target scope and budget 2. EA reporting or business intelligence tool cost EA Training And Pro- motion Budget 1. EA training, workshop budget 2. EA promotion budget Others 1. External expertise cost, etc. EA Maintenance Costs 1. EA maintenance 2. EA hardware and software maintenance 3. EA tool maintenance 4. EA reporting or business intelligence tool maintenance Table ‎4-8: Budget categories for consideration
  • 59.
    59 National Overall ReferenceArchitecture (NORA) – Handbook 5. Roadmap A critical review of the milestones or schedule is necessary. The EA Core Team and working teams have to list and prioritize the expected EA deliverables based on the EA scope. Considerations affecting the schedule includes alignment to the 2nd Saudi e-Government Action Plan, the government agency plans and any need for compliance with Saudi Government policies or projects. At this stage, appoint a Project Manager so that the EA Transition Roadmap can be prepared jointly with EA Core Team. From the EA Transition Roadmap, the next step will develop a detailed Project Plan. Below are examples of EA Transition Roadmap. Figure ‎4-2: Example of EA transition roadmap
  • 60.
    60 National Overall ReferenceArchitecture (NORA) – Handbook 6. Usefulness of EA The final part of the EA development approach is to describe the usefulness of the government agency’s EA that has to match with the original EA Value Proposition(s). Thus, the EA Core Team and working teams have to discuss and list the usefulness of EA especially for the different stakeholders. Table 4-9 describes some of the usefulness of EA. Usefulness Key Content Use in IT planning 1. Check project overlapping, reuse, criteria compliance, etc. in the vision of whole agency 2. Check alignment with agency’s vision, purposes, and target architecture 3. Reflect on IT investment decision and relations. Use in project execution 1. Identify work status, IT systems status, target system requirements, target of reuse, target of shared use, standardization requirements, etc. and reflect them on business plan, work instruction, etc. 2. IT entrepreneur can analyze work status & IT status by using current ar- chitecture and, he can perform business by using EA principles, reference model, target architecture, etc. Use in IT resource management 1. Apply EA principles, reference model, standard, etc. to IT resources management, such as their identification, standardization, reuse, implementation, disuse, etc. Use in Business Process Re-Engineering 1. EA can identify areas for Business Process Re-Engineering, and to build a roadmap for automation of those business processes, in such a case the focus would be more on the Business Domain of EA and less focus on the other domains. Table ‎4-9: Description on the EA usefulness
  • 61.
    61 National Overall ReferenceArchitecture (NORA) – Handbook Table 4-10 below lists are some common examples of EA usefulness mapped into categories. Category EA Usefulness Examples IT & Investment Planning Alignment Prioritize IT projects Ensure no duplication of IT or other projects Merge EA transition / implementation plan with IT plan Identify business areas and services for improvements Budget IT and related projects Identify areas and projects with high capital and maintenance costs Information Alignment Align business (thru Business Reference Model) with financial systems Align business (thru Business Reference Model) with knowledge-based and content management systems (including content on websites and mobile applications) Align business and all application systems thru use of standard data repository and data exchanges (thru Data Reference Model) Business Improve- ments Identify business processes and services that need to meet the stan- dard performance (defined in Performance Reference Model) Identify and improve business processes and services (thru Business Reference Model) IT Project Planning IT project validity review Develop IT master or annual plans Develop IT project plans that are aligned with IT master plan and EA Transition Roadmap IT Project Execution Define scope and requirements based on EA information Design solutions based on target architectures Program manage various IT projects using EA Management System (EAMS) Audit Extract audit checklist items from EA information Prepare for audit with all the enterprise information available in EAMS IT Evaluation Evaluate IT project deliverables against standards and policies defined in EA Post evaluation against EA performance indicators
  • 62.
    62 National Overall ReferenceArchitecture (NORA) – Handbook Infrastructure Op- erations Check for compliance against technology standards & guidelines defined in Technology, Data and Application architectures Capture infrastructure inventories based on definitions in Technology Architecture Plan for improvements, migration and technology refresh of hard- ware and software based on policies and standards defined in EA Table ‎4-10: Examples of EA usefulness categories Table 4-11 list examples in the some agencies. Government Agency Use Scope The Ministry of AAA • Medium-and long-term IT plan and IT investment plan • Establish medium-and long-term IT plan & IT investment plan. Re- view the validity of IT investment plan • Execute IT business • IT plan development, business progress and review. The Ministry of BBB • Select IT project and IT investment plan - Business process improvement, IT planning • Project plan development and contract - Business planning and entrepreneur selection • Establish IT system - IT system development • Operate IT system and manage the asset - System operation, IT asset management. The Ministry of CCC • IT plan development • Budget planning and adjustment • Direction setting for future tech- nologies • Decision of how to introduce IT technology • Project management • Infrastructure Implementa- tion and maintenance • IT asset management • IT system operation • Information protection and security • Information recourses sharing Table ‎4-11: Examples of EA usefulness
  • 63.
    63 National Overall ReferenceArchitecture (NORA) – Handbook Present the EA development approach to the EA Governance Committee for approval. 4.4.3 Step 2.3 Document detailed EA project plan Having obtained the EA Governance Committee’s feedback and approval on the EA develop- ment approach, the team can start documenting the detailed EA Project Plan that will elabo- rate on the objectives, scope, schedules, funding and project management details. The previ- ous outputs, such as the EA development approach, will be use to prepare the EA Project Plan that will be used to track and monitor the progress of all the key steps and activities in the development of the government agency’s EA. Following is an example format for project plan. It is also advisable to prepare the detailed proj- ect schedule based on Microsoft Project. 1. EA Initiative Overview A. Background and Rationale • Specify background and rationale of EA project plan, according to domestic/overseas envi- ronment changes • Specify agency’s IT status and EA rationale in order to solve relative issues • Specify background and rationale of EA project plan in a view of agency’s goals to be achieved by EA implementation ⋅ development B. Provision • Write down service/process’s improvement which can be made by EA after EA implementation C. Scope • Specify scope of EA development project • Specifying EA project’s key contents & EA development scope, since detailed project scope/ contents can be written down in ‘Request for Proposal’ D. Expected outcome • Write down qualitative, quantitative expected outcomes made after completing EA project • It is required to present clearly expected outcomes the agency wants to have through the project since they are related with project’s overall direction.
  • 64.
    64 National Overall ReferenceArchitecture (NORA) – Handbook 2. Current Status/ Issues A. Business Status • Present a work diagram which shows whole work in order to understand agency’s overall work composition • Specify task name, task overview/ function, performing group, related agency, etc. which are included in the project • Write down a chart of the Vendor which performs the project in the agency B. IT Status • Write down as to figure out agency’s overall IT status • Write down application system’s profile in order to figure out the system’s overall size and service contents • Write it down with its basic spec ㅡ hardware(server, disarray), etc. ㅡ in order to figure out tools’ overall size • Write down information with which connection status with external systems can be figured out C. Case Study [Optional Component] • Describe contents about domestic/ overseas EA project cases • Describe implications after analyzing domestic/ overseas EA project cases D. Issues/ Solutions • Describe issues in terms of agency’s business, data, application, connected technology, IT management system, etc. by using results of BPR/ ISP, etc. • Describe issues, limitations, etc. which the agency has when EA implementation/operation • Describe solutions to solve the issues 3. Project Management A. Goals/ Directions • Describe agency’s vision policy goals • Describe overall EA project goals and specific goals which can be achieved by the project
  • 65.
    65 National Overall ReferenceArchitecture (NORA) – Handbook [Example of Project Purposes by an Agency] Keyword The Ministry of AAA The Ministry of BBB The Ministry of CCC The Ministry of DDD The Ministry  of EEE Common use of Information O O Interoperability O O IT System Development O O O Connection of Work with IT O O O O O Using as a Innovation Tool O O EA Implementation Base Devel- opment O O IT Base Development O O O Standardization O O O B. Project Strategy • Describe project strategies suitable to agency’s characteristics • Describe project strategies as to draw success factors from trial projects and other case stud- ies and then, perform the project • Describe whether standard factorsㅡsuch as national EA standard framework, reference model, standard artifact metamodel, etc. ㅡ is applied or not • Describe whether technology assessment standards YEFI, NEA Framework, NORA etc. is observed or not C. Organization/ Process • Describe required organizational structure and their roles • Include CIO, Architecture Committee, Chief Architect, EA Core team, etc. into the agency • Describe structured EA project planning’s responsibility/ roles D. Schedule • Mark project’s total time required, contact period, phase, main events, (beginning and com- pleting session, workshop, law amendment, the first day of service, public hearing, etc.) etc. 4. Project Description A. Project Overview • Explain the project
  • 66.
    66 National Overall ReferenceArchitecture (NORA) – Handbook B. Project Details • Describe detailed project contents by each scope • Describe detailed project contents by each phase C. System Development • Describe a diagram of target system, key functions, and compositions for EAMS development 5. Resources/ Budget A. Budgeting (long-term) • Describe total budget made during the project • Describe how to secure budget B. Budgeting (for the year) • Describe required budget based on the year’s project scope • Describe required budget of the year in detail according to type such as service charge, cost of system setup, purchase of tools, etc. • Describe estimation standard and estimated contents in detail 6. EA Use/ Management A. EA Use • Describe use plan, such as use purpose, use scope, etc. which are defined to use EA information B. EA Management • Describe management system , management purpose, management scope, etc. which are defined to maintain EA information Figure ‎4-3: Example format for EA project plan 4.4.4 Step 2.4 Present and obtain approval for the EA project plan Prepare the presentation slides and review them. It is good to do a presentation to any inter- ested stakeholders first such as CIO or IT department and a business department for their feed- back. Finally present and get approval from the EA Governance Committee.
  • 67.
    67 National Overall ReferenceArchitecture (NORA) – Handbook Continuous Governance
  • 68.
    68 National Overall ReferenceArchitecture (NORA) – Handbook 5. Continuous Governance 5.1 Purpose of governance With the approved EA project plan by the EA Governance Committee in the previous stage, the EA Core and working teams can embark on the detail EA work. As EA is a massive and long-term project, there are bound to be many challenges and issues. It is vital, therefore, that the EA governance work is also address to ensure the success of the project. The previous stage has defined he roles and responsibilities of the EA Governance Committee. Hence, the purpose of the EA governance is very clear, i.e. to steer and direct the EA project to successfully meet the government agency’s vision, mission and strategic goals. Recommended that the EA Governance Committee report to the e-Transformation Committee or one of the e-Transformation Committee members to chair the EA Governance Committee. 5.2 Outcomes of governance The outcomes of the continuous governance are: 1. Up-to-date project reporting on schedules, budget, progress and challenges 2. Pro-active and timely review of deliverables and artifacts (instead of reactive management) 3. Top-down transparency in solving challenges and issues across the government agency 4. Effective management of resources in the government agency. 5.3 Governance initiation The government agency’s e-Transformation Committee started the governance by reviewing and approving the EA Project Strategy in Stage 1. The EA governance officially started with the formation of the EA Governance Committee in Stage 2. Note that the EA governance is a con- tinuous activity affecting all stages.
  • 69.
    69 National Overall ReferenceArchitecture (NORA) – Handbook 5.4 Key areas in EA governance The key areas in EA governance are listed in Table 5-1. Stage / Step No Description Deliverable All Continuous Governance Success of Government Agency’s EA Project 1. Track and monitor the key activities and deliverables of the EA. Highlight to EA Governance Committee on potential delays, changes in scope, and lack of resources Program management of Gov- ernment Agency’s EA implemen- tation 2. Manage the introduction and changes to the various activities in the EA. In particular, carry out activities on EA awareness and promotion Change management especially on awareness and promotion of Government Agency’s EA 3. Manage the capability requirements for the EA implementation that includes training, changes to job scope, and review of division / department organizational structures Capability management on the progression on the government agency’s capabilities to carry out the EA Project plans 4. Manage the policies and regulations re- quired to implement the different factors or activities of the EA in the government agency Policy management on the poli- cies and regulations relating to the EA execution 5. Manage the performance outcomes of the EA in the government agency Performance management on the metrics, KPIs and outcomes of the EA Table ‎5-1: Continuous governance steps As EA affects the whole of the government agency’s functions, and not merely IT, it is vital that the EA Governance Committee has to carry out its governance functions throughout the EA lifecycle.
  • 70.
    70 National Overall ReferenceArchitecture (NORA) – Handbook The EA governance covers five areas as summarized in Figure 5-1 - program management, change management, capability management, policy management and performance manage- ment. Note that these five management areas have to be planned and executed together rather than in sequence. Through program management, which acts as a central management area, specific projects and tasks can be planned, scheduled and monitored. Details of these gover- nance areas are describe below. Figure ‎5-1: Five Aspects of EA governance
  • 71.
    71 National Overall ReferenceArchitecture (NORA) – Handbook 5.4.1 Program management The EA will be a continuous journey with dynamic changes affecting different parts of the ar- chitectures and reference models. The EA also recommends initiatives that require time to de- velop and fully implemented. The EA Core team must program manage the EA journey. The following are the key activities: 1. Update the program plan for the main initiatives and projects resulting from the development phases, in particular the target architectures 2. Brief and propose on what and when to alert the EA Governance Committee for activities and projects that are delayed, faced complex issues or require additional resources and funding 3. Have a regular meeting (e.g. monthly) to update the EA Governance Committee 4. Have a regular meeting (e.g. weekly) among the Chief Architect, EA Core team and working teams 5. Where possible, to delegate one specialist staff to manage one big program or project such as change management, capability management, policy management and performance manage- ment. 5.4.2 Change management Before EA exists, the government agency has been organizing, planning and executing projects (both business and IT) in typical manual and reactive fashion. The introduction of EA requires big changes to the government agency such as organization review, integrated & strategic plan- ning, and making decisions on e-Government transformation projects in a structured and time- ly way. Thus, change management is necessary for the success of the EA execution. Basis for change management The plans for the long-term change management require approval from the EA Governance Committee. In addition, constant updates to the EA Governance Committee and even to the other top management in the government agency is recommended. This is to ensure that top management or the e-Transformation Committee is aware of the progress and changes to the EA program.
  • 72.
    72 National Overall ReferenceArchitecture (NORA) – Handbook The EA Value Proposition - as part of the EA Strategy - was prepared, presented and approved by the top management or e-Transformation Committee in Stage 1. The team can use and up- date this document as the basis for EA change management. In particular, the EA change man- agement has to address the following: S/No Stakeholders Why EA? 1 Top Management a. Meet strategic goals b. Improves IT spending and investments c. Compliance with Saudi e-Government Action Plan 2 Business Owners a. Improves business efficiency & effectiveness b. Increases number of e-services c. Better services to citizens and businesses 3 IT Staff a. Prioritize IT projects b. Quality IT deliverables 4 Operations Staff a. Improves personal work efficiency b. Better, integrated work processes c. Better services to citizens and businesses Table ‎5-2: Need for EA change management Scope of change management The development and updates of the EA artifacts or deliverables are part of change management. These artifacts have to be produced, reviewed, amended, published, communicated and main- tained. More importantly, change management covers the awareness of the EA project, and the promotion of EA as a strategic transformation enabler for the government agency. When all employees understand about EA – from top management to the operations staff – only then can EA be a success. In short, change management has to address three key areas – EA artifacts management, EA awareness and EA promotion.
  • 73.
    73 National Overall ReferenceArchitecture (NORA) – Handbook 1. EA Artifacts Management As early as possible (at least by Stage 4 i.e. develop EA Framework), the EA Core team has to establish artifacts management processes and standards that will ensure quality deliverables are documented, updated and approved. The main processes are: a. Artifact review and approval management process b. Artifact release management process c. Artifact change management process d. Artifact compliance management process. The EA Core team has to develop minimally the above management processes. Below is an example of one the processes. Artifact Review and Approval Management Process As there will be many artifacts and documents produced in the course of the EA development, it is necessary to have a standard process to review and approve the various documents. It is assumed that the government has its own version control process in place (which is not covered in NORA). Figure 5-2 illustrates an example process for the review and approval of artifacts.
  • 74.
    74 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎5-2: Example of artifact review and approval process In this example, there are four reviews before the final approval for the artifact or documenta- tion. Each review starts by checking-out the artifact. The feedback for each review is collected for amendment. Note that each review may have multiple occurrences. The basic description of the reviews are as follows: a. Core team review Mainly the Chief Architect and the EA Core team members will do the first review. This review is to ensure accuracy of content and the inter-relationships with other EA artifacts.
  • 75.
    75 National Overall ReferenceArchitecture (NORA) – Handbook b.Working team review The working team members can then review for applicability as they are aware of the specific requirements and operational implications. c. External review The third review is by an external team that may be within the government agency or even oth- ers. This review is to get inputs from stakeholders. d. EA governance committee review Finally, the governance committee will be presented with the artifact for their review and com- ments. For each of the four reviews, the EA Core team members have to do the following editorial tasks: i. From the feedback obtained, update the artifact or document ii. ‘Scrub’ the artifact or document for basic quality such as grammar & spell check, formatting, fonts, etc. as defined in the EA documentation standard iii. Validate the artifact or document to ensure that correctness of basic content including com- pliance to the EA documentation standard iv. This is followed by ‘proof read’. This step is to ensure that the content can be understood v. Finally, the artifact or document is verified to ensure correctness of content and its inter- relationships with other artifacts vi. The artifact or document is then check-in. 2. EA Awareness The need and importance of EA has to be communicated to all the government agency staff, in particular to the stakeholders identified above. Awareness campaigns such as presentations, workshops and seminars can be conducted. It is recommended that the EA Core team and working teams discussed the most effective ways to execute the awareness. The tables below show examples of how and what content are to be provided in the EA awareness sessions.
  • 76.
    76 National Overall ReferenceArchitecture (NORA) – Handbook Awareness Method Target Audience Frequency Presentation (including updates on EA Program) Top Management Quarterly Presentation IT Management Once Presentation Business Owners Once Workshop IT & Business Staff Quarterly Table ‎5-3: EA awareness methods Awareness Method Estimate Duration Suggested Content Presentation (Top Management) 1 hour i. EA Goals & Objectives ii. Need for EA in Government Agency (i.e. benefits) iii. EA Transition Roadmap iv. Synergize EA with Strategies and Investment Decisions v. Progress Update Presentation (IT and Business Own- ers) 2 hours i. EA Goals & Objectives ii. Need for EA in Government Agency (i.e. benefits) iii. High Level Current Architecture iv. High Level Target Architecture v. EA Transition Roadmap
  • 77.
    77 National Overall ReferenceArchitecture (NORA) – Handbook Workshop 1 day i. EA Goals & Objectives ii. National Enterprise Architecture (NEA) for Saudi Government iii. Need for EA in Government Agency (i.e. benefits) iv. Current Issues & Challenges v. High Level Current Architecture vi. Possible Solutions vii. High Level Target Architecture viii. EA Transition Roadmap ix. How Can Staff or Division Contrib- ute to EA Table ‎5-4: Suggested content for EA awareness As EA can only be a success if the government agency starts to think and act strategically, it may be necessary to conduct additional awareness sessions to specific stakeholders such as the stra- tegic and finance divisions. These stakeholders are potentially required to conduct integrated strategic and financial investment decisions of the government agency. 3. EA Promotion Complementing the awareness program above, the EA has to be promoted so that both man- agement and operational staff in the government agency can identify the value that EA brings forth. It is recommended that the EA Core team work with the media or public relations in the government agency to finalize and implement the promotion. The following are the key steps for consideration in the EA promotion:
  • 78.
    78 National Overall ReferenceArchitecture (NORA) – Handbook Activity Description Purpose of promotion Identify the actual purpose in the EA promotion. This may affect the scope and budget of the promotion campaign Understand how management and staff receives promotional messages Analyze the typical behavior when promotional messages are communicated to management and operational staff in the government agency. This helps to design the promotion package Design promotion key message While there are many goals and benefits of EA, the team needs to design a short message(s) that the management and staff can understand Design the tag line / logo Finally, design the tag line or phrase for the EA. This is something catchy that can be easily remembered. Also the team may consider designing a logo or special dia- gram of the EA Determine the effective media for promotion In addition to online media such as Intranet and email, the team can consider other options including social me- dia, videos, physical posters and physical gifts (e.g. mugs, mouse-pad, and USB thumb-drive). Typically the promo- tion has a number of these combinations Produce and promote the EA With the above in place, the team can finally produce the final EA promotion package Table ‎5-5: EA promotion activities It is also highly recommended to conduct an annual EA seminar to disseminate latest progress updates and show the next projects in the pipeline. Other government agencies can also be invited to share their success stories.
  • 79.
    79 National Overall ReferenceArchitecture (NORA) – Handbook 5.4.3 Capability management Not only does EA requires a big organizational change, but it also requires commitment of the government agency to continuously improve its capability – i.e. thought processes in executing work, improving skills & experiences in architecting, improving business processes & automa- tion, and in integrated planning & decision-making. Complementing the change management, the capabilities of the government agency can be classified into the following areas: 1. Enterprise Architecture Although the Chief Architect, the EA Core team and working teams have completed the EA development, the EA still requires continuous maintenance and updates. Hence, from a sustain- ability perspective, the government agency requires sufficient staff trained in EA. There is a need for specialization in the different areas of EA such as Business Architecture, Application Architecture, Data Architecture and Technology Architecture. These specialization requires additional training and learning from other architects. 2. Business Automation (including efficient use of IT devices) Through EA, there will be proper alignment of business and IT. To see the outcomes of the EA, however, requires effective business automation. It is not simply to use IT to replace the manual way. More importantly, it is to review and im- prove the business processes, and improve the team/division structure that executes these processes. Capabilities such as ability to operate efficiently mobile devices, business process re-engineering / improvement and organization reviews are required.
  • 80.
    80 National Overall ReferenceArchitecture (NORA) – Handbook 3. Integrated Planning For a more effective planning and decision-making, EA aids the review, planning and managing the projects in the government agency. The EA target architectures and reference models allow synergy with the strategies / action plans of the government agency. This should be the focus when the EA is fully completed (please see Execution Stage). 4. Service-based Outcomes As Saudi government agencies continuously strive to improve their services to the citizens, busi- nesses and government employees, it is necessary to deliver service-based outcomes. In other words, government agencies have to consider what and how the government services can be implemented that are useful for the public. The target outcomes of EA are objects, components and services. For example, a government function is supported by application systems based on a set of re-usable application components; in addition, the government function is made up of a number of business processes that deliver specific services to the public. Through EA, services and e-services are readily identified.
  • 81.
    81 National Overall ReferenceArchitecture (NORA) – Handbook Table 5-6 summarizes the capabilities required in EA execution. S/ No Capability Description Who 1 Enterprise Architects To design, architect and implement enter- prise IT-Business solutions and initiatives Suggested Trainings: i. NEA Briefing ii. TOGAF/FEAF or similar iii. Visit similar government agency (local or overseas) to learn EA experiences. Staff who knows both IT and Business 2 Business Process Re-engineering (BPR) To review, improve and re-engineer the efficiency and effectiveness of business processes Suggested Trainings: i. BPR or similar ii. Visit similar government agency (local or overseas) to learn how they improve their business processes. Business Owners, Business Process Experts 3 Integrated Planning To plan as a government-wide integrated program (rather than by division or by resource e.g. IT & finance) Suggested Trainings: i. Corporate Integrated / Collaborative Planning or similar. Strategic Planners, Enterprise Architects, Business Owners, Corporate Planners 4 Public service design To design and implement services that are needed by the public – i.e. citizens and businesses. Also to provide outcomes as services instead of government authorita- tive requirements Suggested Trainings: i. Service value ii. Public service design Business Owners, Operational Staff Table ‎5-6: Capabilities required in EA
  • 82.
    82 National Overall ReferenceArchitecture (NORA) – Handbook 5.4.4 Policy management In the development of the EA, the teams would have difficulties to identify things as a standard or a guideline. While this is normal, the EA execution requires policies and regulations to ensure a government agency-wide standardization and adoption of the various architectures / refer- ence models. For effective governance or management, the EA Core team and working teams have to prepare and implement the relevant approved policies. It is recommended that these EA policies be implemented in phases in conjunction with the Change Management Plan. Examples of policy or regulation areas in EA are: 1. EA Usage Plan 2. EA Management Direction 3. Compliance to Project Approval Process 4. Compliance to Architectures & Reference Models 5. Compliance to Technology Standards. 1. EA Usage Plan While the EA Core and working teams are busy preparing and developing the EA, the EA Gover- nance Committee has to set clear directions on the eventual usage of the EA – i.e. when to use or implement the EA (or parts of the EA) and who will implement the EA (in terms of divisions, departments and branches). The table below lists the main activities to identify EA usage plan direction and scenario, while the subsequent diagram shows examples of EA usage direction. Clear policies or direction state- ments can be defined and be communicated to all parties in the government agency on the us- age of EA. The actual development of the detailed EA Usage Plan is typically carry out in Stage 9.
  • 83.
    83 National Overall ReferenceArchitecture (NORA) – Handbook S/No Activity Description 1. Identify usage plan direction • Identify EA usage cases from the EA best practices and trends • Identify EA usage types based on EA requirements and the result of best practices analysis 2. Identify usage scenario • Identify EA usage scenario from best practices and trends • EA usage scenario can be developed by merging of use cases and identifying of EA requirements 3. Define EA usage plan policy or regulation • Draft the relevant policies or regulations • Review and obtain feedback; carry out relevant updates • Obtain EA Governance Committee approval Table ‎5-7: Activities to define EA usage plan Figure ‎5-3: Example for EA usage direction
  • 84.
    84 National Overall ReferenceArchitecture (NORA) – Handbook 2. EA Management Direction Although some of the EA requirements were gathered in the early stages of the EA develop- ment, it is a good governance practice to review and update these requirements. The EA Gov- ernance Committee has to set clear management directions for both the development of the EA, and the implementation of the EA. The purpose of this activity is to define EA management direction by referring to agency’s EA requirements, EA architecture principles, EA usage plan and the developed artifacts. Setting the main management directions require comprehensive information from trends analysis and new technologies including considerations for political and social factors. The EA Governance Committee has to consider all other governance aspects such as change and per- formance management, in defining necessary policies or regulations on the EA management direction. Below are descriptions to define the management direction and examples. Note that the actual EA management plan will be drafted in Stage 9. S/ No Activity Description 1. Identify EA management plan direction • Identify EA management plan cases from the EA best practices and trends • Identify considerations of EA management plan in EA principle, purpose, and scope 2. Identify environmental analysis & requirements • Identify architecture requirements from IT trends analysis and agency’s strategy information in environmental analy- sis results • Identify architecture development scope by each area • Identify EAMS operating information • Identify information which EA management plan needs to support in EA usage plan development • Identify the key consideration for EA management plan 3 Define EA management policy or regulation • Draft the relevant policies or regulations • Review and obtain feedback; carry out relevant updates • Obtain EA Governance Committee approval Table ‎5-8: Activities to define EA management plan
  • 85.
    85 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎5-4: Example for EA management plan direction 3. Compliance Policies The EA Core and working teams have to draft relevant policies, regulations or direction state- ments to ensure that the various parties or divisions in the government agency will use and comply with EA standards and guidelines. All the policies or direction statements will require review and approval by the EA Governance Committee. It is also important to ensure that these policies are clearly communicated to all parties in the government agency. 5.4.5 Performance management As a strategic enabler, EA provides the ability to define and measure performance of the gov- ernment agency. While this can be incorporated into the Performance Architecture (which is optional), the execution of EA nonetheless requires performance metrics to be defined so that management knows whether the EA project has been a success. The performance metrics have to be aligned with the Saudi e-Government Action Plan and the government agency’s strategies and plans. Corporate score cards, national government and local government indexes can be used to derive the key performance indicators (PKIs). The performance metrics should also be use in the strategic planning by the government agency. An example of a performance metric is in Table 5-7.
  • 86.
    86 National Overall ReferenceArchitecture (NORA) – Handbook S/No KPIs Target Not Performing Under Performing Performing A Strategic Planning 1 Alignment to Saudi e-Govern- ment Action Plan 90% Less than 70% Less than 90% Meet or Exceed 90% 2 Incorporate Government Agency’s Strategies & Plans 95% Less than 70% Less than 95% Meet or Exceed 95% B Drive out Duplications of ICT Investments 3 Improve business processes (through BPR or reviews) 5 business processes 0 -2 3 Meet or Exceed 5 4 Use National Shared Applications 2 Applications 0 1 Meet or Exceed 2 5 Share Data with Government Agencies (Give or Receive) 5 Data Sources 0 -1 3 or less Meet or Exceed 5 6 Remove or Replace Applications with Obsolete Technologies 75% Removal or Replaced by year XXXX Less than 50% Less than 75% Meet or Exceed 75% C Increase Indirect Value of Government ICT Investments 7 Use National ICT Infrastructure or Initiatives where possible 4 National ICT Infrastructure 0 - 2 3 Meet or Exceed 4 8 Use Government Agency-Wide Application Framework & Components (promote re-usable services) 5 Application Components 0 - 2 3 Meet or Exceed 5 9 Transform manual communica- tions within and among govern- ment agencies into electronic 95% Less than 50% Less than 75% Meet or Exceed 95% D Contribute to the Establishment of Information Society in KSA 10 Deliver services and information electronically 95% Less than 50% Less than 75% Meet or Exceed 95% 11 Transform manual communications with public into electronic 90% Less than 50% Less than 70% Meet or Exceed 90% Table ‎5-9: Performance metrics example
  • 87.
    87 National Overall ReferenceArchitecture (NORA) – Handbook Stage3–Analyze CurrentState
  • 88.
    88 National Overall ReferenceArchitecture (NORA) – Handbook 6. Stage 3 – Analyze Current State 6.1 Stage summary With the approved EA project plan in place, the EA Core and working teams can start the actual work by analyzing the current state of the government agency. This stage describes the key activi- ties in reviewing and analyzing the different aspects of the current state of the government agency. 6.2 Stage purpose The government agency has to carry out requirements study and detailed analysis of the current state in terms of both business and IT. The following specific expected outcomes from this stage are: Define the government agency’s EA requirements (mainly from key stakeholders) Document the government agency’s environment analysis report – both internal and external analysis Document the government agency’s current strengths, weaknesses, opportunities and threats (SWOT). 6.3 Stage initiation This stage begins with the endorsement or approval of the EA Project Plan from Stage 2. 6.4 Key steps in stage 3 This stage kicks off with documenting the government agency’s EA requirements and the current business and IT landscapes (through environment analysis). This document will help to steer the EA journey in the following stages. The key steps in Stage 3 are listed in Table 6-1.
  • 89.
    89 National Overall ReferenceArchitecture (NORA) – Handbook Stage / Step No Description Deliverable 3 Analyze Current Stage a. EA Requirements b. EA Environment Analysis Reports (Current Business Landscape and Current IT Landscape) c. SWOT Analysis Report 3.1 Gather and document EA require- ments from various stakeholders such as e-Transformation Commit- tee, EA Governance Committee, main business functions’ stakehold- ers, and EA working teams Government Agency’s EA requirements reviewed by EA Governance Committee 3.2 Gather and analyze Government Agency’s internal environment such as organizational capability to plan and execute e-transformation plan, business plan and IT plan Government Agency’s EA environment analysis report reviewed by EA Gover- nance Committee 3.3 Gather and analyze Government Agency’s external environment such as general trends in EA, United Nations or similar e-Government rankings including recommenda- tions, prioritized national projects and new government policies Government Agency’s EA environment analysis report reviewed by EA Governance Committee 3.4 Present to the EA Governance Com- mittee EA Governance Committee is informed about the detailed current state of the government agency Table ‎6-1: Stage 3 steps
  • 90.
    90 National Overall ReferenceArchitecture (NORA) – Handbook 6.4.1 Step 3.1 Gather and document EA requirements Like any big and complex project, it is important to get clear requirements. In Stage 1, the EA was introduced to the government agency and basic requirements or directions were obtained. In this stage, more detailed requirements have to be gathered from different stakeholders in the govern- ment agency. Getting and documenting the EA requirements require a number of activities. The following progressive set of activities are recommended: 1. Plan the type of information required and from which stakeholders 2. Prepare another round of awareness sessions on EA to the stakeholders including those in middle management and even operations staff 3. Design a set of questionnaire to capture basic requirements on common problems in the gov- ernment agency (this output is useful not only for EA but for other organizational and IT im- provements); this questionnaire can be manual or preferably in electronic version (please see Table 6-2 for example) 4. Conduct the EA awareness sessions and send out the questionnaire 5. Review and analyze the questionnaire’s responses; and document the main findings 6. From the main findings, the team can start to interview key stakeholders to verify these findings and to obtain more requirements. Please refer to Table 6-3 for example format of documenting the stakeholders’ requirements. The recommended stakeholders would be: a. IT infrastructure team such as network, helpdesk and IT support teams b. Data teams such as IT DBA and owners of data (if available) c. IT application development team such as IT Manager and Application Analyst d. Application and e-service Owners (business staff) e. CIO and top management. 7. Document the final EA requirements and present to the EA Governance Committee.
  • 91.
    91 National Overall ReferenceArchitecture (NORA) – Handbook Question Areas Example Questions Organization a. Is there a clear vision and mission for the government agency? b. Are staff aware of the government agency’s plans (business, IT, etc.)? c. Is there a mandate on the goals of e-transformation plan for the gov- ernment agency from its management? d. How would they rate the government agency’s capability to manage influences and factors caused by external factors such as economic changes, politics, social impacts, environmental demands and technology innovations? e. Are there quality standards or key performance indicators defined for the government agency? Business Performance a. Are the various business functions and business services measured? b. And are they aligned with the government agency’s quality standards or KPIs? c. What are the key issues faced by the business functions? e. How are business functions’ challenges and problems being ad- dressed? In particular, how to resolve inter-department or inter-divi- sion issues? Application / Solutions a. Who decides the need for an application / solution automation? b. Who budgets or funds for the development of these applications / solutions? c. Are there are standards for developing or choosing an application / solution (including the platform such as mobile, stand-alone, web- based, etc.)? d. Are the applications / solutions shared across divisions or departments? e. Does the government agency access other government agencies’ ap- plications? If yes, please collect the list of applications / solutions f. Is there a standard authentication mechanism to access the various applications / solutions?
  • 92.
    92 National Overall ReferenceArchitecture (NORA) – Handbook Data / Information a. Who decides on the ownership of data? b. Is data or information being shared within the government agency across the divisions, departments and branches? c. Are there any data shared with the citizens, business or other government agencies? If yes, please list the data d. Are there any data duplications in the government agency? e. Are there incidents of lost or stolen data? IT Infrastructure a. Is there a shared network within the government agency? b. Is there government agency connected to the Saudi Government Network? c. Can staff access internet? d. Are staff given a PC or digital device? e. Is office automation (email, e-documentation) a common practice in the government agency? f. Are there security measures to protect the IT infrastructure? Table ‎6-2: Example questionnaire Stakeholders What (Data or Information) How (Things to be done) Why (Reason) Where (Things to be done) Who (To carry out) When (To carry out) Top Management Business Owners Data Owners Application Developers IT Infrastructure EA Core Team Table ‎6-3: Example format to gather EA requirements
  • 93.
    93 National Overall ReferenceArchitecture (NORA) – Handbook 6.4.2 Step 3.2 Analyze internal environment While the previous step gives the EA working team a very good idea about the EA require- ments, the team has to also understand where does the government agency stand in terms of its organization’s EA maturity & capability. Thus, both an internal and external environment analysis have to be carried out. Start by reviewing the documents prepared in Stage 1 - relevant EA trends and case studies relating to the government agency, and the government agency’s e-transformation maturity. The basic idea of internal environment analysis is to know the maturity level of the government agency from an internal perspective – both from an organization and IT areas. This information would help shape the EA outcomes in the next few stages. The outputs from Stage 1 have to be reviewed and understood. A more detailed analysis is now required as summarized in Table 6-4. Analysis Area Analysis Measurement Expected Outcomes Organizational Review Vision and Mission Alignment Identify gaps in mission/vision & objectives Business Functions / Tasks Identify gaps or misalignment of tasks to overall objectives IT Review Business and IT Alignment Identify gaps or misalignment of applications to business IT Standards IT interoperability issues Table ‎6-4: Internal analysis areas & expected outcomes
  • 94.
    94 National Overall ReferenceArchitecture (NORA) – Handbook Organizational Review In this review, the team has to carry out 2 measurements – vision and mission alignment and how the business functions or tasks support the overall goals or objectives. For both measure- ments, the analysis is based on the government agency’s organization chart including its vision, mission and objective statements. For a start, the team must obtain these latest organizational information. 1.Vision and Mission Alignment a. This measurement is to answer the strategic question i.e. are all business units in the govern- ment agency aligned to its overall vision, mission and objectives? b. Check and evaluate the vision and mission statements; thus the teams need to really under- stand what exactly the government agency is set up to do c. Find out if the various departments or divisions or branches have their own vision and mis- sion statements; ensure that they are aligned to the main statements. Sometimes, a division or department embarks on its own set of vision and mission statements that do not align to the government agency’s main vision and mission statements d. Analyze how the government agency’s broad objectives are supported by the various de- partments and divisions. It may be common that these objectives may be directed to more than one department or division e. Refer to the government agency’s action plan or roadmap; this would help to understand and map the activities f. Document the abnormalities or gaps among the goals and objectives and how they are not directly mapped to the departments and divisions (if any). g. Capture ‘Agency E-transformation plan’ and ‘Objectives’ related to agency for the National Data Gathering as shown in the annex C(NEA Meta-Model)
  • 95.
    95 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎6-1: Example of Vision/Mission alignment with goals and initiatives 2. Business Functions / Tasks a. This measurement is to answer the strategic question i.e. are all business functions / tasks clearly defined and executed or are there grey areas and unclear business functions / tasks? b. Similarly like above, find out how government agency’s objectives and goals are mapped to the different functions / tasks c. Please see Figure 6-1 as an example d. For e.g. Goal 3 would have Strategy 2 and followed by Initiative 3; this initiative has to be mapped to a business function / task and then to a department or division e. Document those that are not properly mapped or unclear or with duplicates.
  • 96.
    96 National Overall ReferenceArchitecture (NORA) – Handbook IT Review In this review, the team has to carry out two measurements – business and IT alignment, and the IT standards. It would be good if the government agency can document its IT landscape (i.e. a detailed description and inventories of all the IT-related assets, systems. applications and data). Other useful sources of information include IT Portfolio if available. If none of these are available, the IT teams have to use whatever inventories they have. For a start, please carry out an update on all the IT inventory to get the latest information. The following figures are examples of the IT review outcomes. 1. Business and IT Alignment a. This measurement is to answer the strategic question i.e. are the core business functions of the government agency effective and being supported by IT automation? b. Review the IT Plan of the government agency; for each major IT project or application sys- tem, analyze to see if it supports a business function or task c. Similarly review the data used in the government agency; for each data entity type (for e.g. Citizen, Employment and Government Agency), check how the business functions and tasks utilize it – either Read, Write, Update or None at all. Also check for data duplications d. Another perspective is to sort all the IT systems and data by the various business functions; from here, it is easy to analyze which business functions have the highest rate of IT adoption e. Document these findings and analysis. f. Capture the IT Project related information for National Data Gathering as shown in the annex C(NEA Meta-Model).
  • 97.
    97 National Overall ReferenceArchitecture (NORA) – Handbook Division Name/Department Name Division Name/Department Name Division Name/Department Name Systems Independently Implemented & Operated Separate information systems,..etc Data Duplication Clients information duplications, Services information discrepancies across divisions,.. etc Government Dynamic Directions New services Requested,..etc Duplicated Information Complicated Linkage Structure DB1 CRM Purchasing Inventory DB2DB2 Division Name/Application Owner Purchasing System Inventory System Correspondence System Duplication Examples Date Set A Date Set B Date Set B Date Set B Date Set B Date Set B Date Set B IT Status -Core Issues & Problems Figure ‎6-2: Example of business and IT alignment
  • 98.
    98 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎6-3: Example of major IT systems supporting government functions
  • 99.
    99 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎6-4: Example of IT systems supporting government functions by business areas 2. IT Standards a. This measurement is to answer the strategic question i.e. how pervasive is the use of IT in the government agency, and does the IT adoption comply with specific standards? b. The teams have to analyze a few key IT areas such as infrastructure, data, applications and e-services c. For infrastructure, areas of measurement include network penetration (i.e. how much net- work has been installed in the government agency, and the network utilization), IT devices adoption rate, maturity of data center, and servers & storage d. Database standards, data definitions and data exchange methods are to be analyzed e. For applications, the teams have to review the application development standards, application platform standards, application testing and deployment to name a few f. Last but not least, review the standards used to design, develop and deploy e-services (not that the measurement of e-services maturity can be obtained from Yesser) g. Consolidate and document the IT Standards measurements.
  • 100.
    100 National Overall ReferenceArchitecture (NORA) – Handbook 6.4.3 Step 3.3 Analyze external environment External environment analysis is to gauge the external factors that influence the government agency. It also allows comparison between a government agency and other similar agencies. This information would help shape the EA outcomes in the next stages. The outputs from Stage 1 – EA Trends and case studies - have to be reviewed and understood. View external environment analysis from two perspectives – external factors and external scope. Examples of external factors include political, economic, social, technology and nature/environ- ment. These factors cause multiple impacts to the government agency. An example of an exter- nal scope is the region for analysis such as within the city (e.g. Riyadh), or country (e.g. KSA), or region (e.g. GCC) or globally. Different external scope of perspectives would have different impact to the government agency. The following are the key activities of external environment analysis: 1. Based on the stakeholders’ requirements from previous step, determine the external scope of coverage – i.e. to determine if the analysis is only within the country or regionally for example 2. From the initial findings in Stage 1, determine the additional scope required; ensure that a rea- sonable scope of analysis can be carried out (and better to narrow the scope initially) 3. Carry out a SWOT analysis (Strengths, Weaknesses, Opportunities and Threats) 4. Compare some of the SWOT analysis with other external reports like United Nations, and direct comparisons with government agency in another country or region 5. Document the SWOT findings and comparisons into the external environment analysis report.
  • 101.
    101 National Overall ReferenceArchitecture (NORA) – Handbook Table 6-5 is an example of a SWOT Chart Template. SWOT Chart Template • Strengths: • What the government agency does well in? • What unique resources and capabilities can the government agency draw on? • What advantages does the government agency have? • What do citizens and businesses see as the government agency’s strengths? • Weaknesses • What could the government agency improve on? • What should the government agency avoid? • What do citizens and businesses see as the government agency’s weaknesses? • Opportunities • What promising options are open to the government agency? • What are the interesting trends the govern- ment agency is aware o government f? • How can the government agency convert its strengths into opportunities? • Threats • What obstacles does the government agency face? • What trends could hinder the govern- ment agency? • What are other government agencies doing? • Are the required specifications for the services provided by the government agency changing? • Is changing technology threatening the government agency? • Could any your weaknesses seriously threaten the operation of the govern- ment agency? Table ‎6-5: SWOT chart template At the end of this stage, the EA requirements together with the environment analysis reports would help the EA Core team to understand how the government agency’s EA can help to resolve these issues and meet the requirements.
  • 102.
    102 National Overall ReferenceArchitecture (NORA) – Handbook 6.4.4 Step 3.4 Present current state analysis Present these findings of the government agency’s current state to the EA Governance Committee for information and comment. Through this presentation, the governance committee is aware of the current challenges, issues, threats and even possible opportunities. From their collective wisdom, the EA Governance Committee can provide strategic directions for subsequent EA development. If required, the EA Governance Committee may also want these findings to be presented to the e-Transformation Committee or equivalent.
  • 103.
    103 National Overall ReferenceArchitecture (NORA) – Handbook Stage4–Develop EAFramework
  • 104.
    104 National Overall ReferenceArchitecture (NORA) – Handbook 7. Stage 4 – Develop EA Framework 7.1 Stage summary This is the stage where a government agency starts to develop its EA. In this stage, the government agency constructs the main pillars such as EA vision & mission, architecture goals & principles, EA Framework, taxonomy, and other related standards that is fundamental to its EA journey. The gov- ernment agency should focus on building quality EA framework and other relevant processes. If I had 8 hours to chop down a tree, I’d spend 6 hours sharpening my axe “ ~ Abraham Lincoln 7.2 Stage purpose The previous stage gave the EA requirements and environment analysis reports so that the EA Core team knows what the government agency’s EA has to address. The purpose of stage 4 is to architect important EA fundamentals that will steer and guide the EA development in subse- quent stages. The following specific expected outcomes from this stage are: 1. Define the government agency’s EA vision, mission, architecture goals and architecture principles 2. Define EA documentation standard 3. Define EA artifact review and approval process 4. Create the government agency’s EA Framework.
  • 105.
    105 National Overall ReferenceArchitecture (NORA) – Handbook 7.3 Stage initiation This stage begins with the completed EA requirements, environment analysis reports (both current business and current IT landscapes) and the SWOT analysis report from Stage 3. Note that the EA Governance Committee may also provide additional strategic requirements at the end of Stage 3. 7.4 Key steps in stage 4 Stage 4 focuses on high level architecture activities that require experience and vision. The key steps in Stage 4 are listed in Table 7-1. Stage / Step No Description Deliverable 4 Develop EA Framework 1. Government Agency’s EA Mission, Vision, Architecture Objectives and Architecture Principle Statements 2. Government Agency’s EA Framework 4.1 Define EA’s vision and mission state- ments, & architecture objectives Draft EA Vision, Mission, , and architecture objectives 4.2 Define EA’s architecture principles Draft EA Principles 4.3 Present and obtain approval for EA vi- sion, mission and architecture objectives Approved EA Vision, Mission, Architecture Objectives and Architecture Principles 4.4 Define EA Framework structure Draft EA Framework Structure 4.5 Design EA architecture elements Draft EA Architecture Elements 4.6 Design EA model Draft EA Model 4.7 Develop EA documentation standard EA documentation standard 4.8 Develop EA artifacts management processes Draft EA Artifact management processes 4.9 Present and obtain approval for EA framework Approved EA Framework Table ‎7-1: Stage 4 steps
  • 106.
    106 National Overall ReferenceArchitecture (NORA) – Handbook 7.4.1 Step 4.1 Define EA’s vision and mission statements, & architecture objectives The EA Core team should work on developing an EA vision and mission that represents the government agency’s primary EA purpose and value. The vision and mission should be followed and articulated by the EA’s future roles & directions for successful EA establishment / usage. It should also be clearly understood to the government agency’s stakeholders and they can grasp its definition at a glance. The EA vision should be a long-term statement about what the EA is, and why it is an important future outcome for the government agency. The EA mission statement, on the other hand, describes at a high level, about how the EA can be a vital asset for the government agency. Both these statements should be short and simple. Below are some examples of vision statement. Figure ‎7-1: Example of a Vision statement
  • 107.
    107 National Overall ReferenceArchitecture (NORA) – Handbook The following activities are recommended for the EA Vision and Mission statement development: 1. From the EA requirements and environment analysis reports, shortlist key words that help to shape the future EA. Examples are words such as performance-driven, agile government, effec- tive decision making, business-IT alignment, IT investments, and citizen-centric services 2. Review the government agency’s vision and mission statements, and extract key words that affect the EA development 3. Check for the IT vision and mission statements (if any). If available, extract key words that match with the shortlisted key words above 4. Consolidate all the key words for the vision and mission statements 5. Conduct a brainstorming session among the EA Governance Committee and EA working teams to define the vision and mission statements 6. Define the architecture objectives of the EA based on the vision and mission statements 7. The team may also want to get feedback from other stakeholders such as specific business divisions and even the top management. Update these statements from their feedback 8. Table 7-2 is a guideline on the considerations for effective vision and mission statements.
  • 108.
    108 National Overall ReferenceArchitecture (NORA) – Handbook Area Consideration Understandability • A vision and mission statement should be clearly understood and promptly captured by EA stakeholders • Definitions and use of certain terms within the agency can increase understandability Solidity • Consider the missions, values, and directions that the current government and e-Government program are pursuing • An EA vision / mission statement that is linked to agency’s established values can easily convince internal EA stakeholders Consensus • An EA vision / mission statement should be created based on all stake- holders’ consensus and awareness • An EA vision / mission should be agreed upon and recognized within an agency to be successful Alignment • All architectural areas should be aligned with a given EA vision because EA vision is a guide that directs other elements such as EA purposes, principles, and framework. This makes an EA consistent and unified Usability • EA vision / mission should be connected to agency’s business purposes in order for EA to be used in various business processes • Consider how to realize EA vision / mission in each area of an agency (Organization, H/R, Businesses, etc), and adjust EA management and evaluation process Table ‎7-2: Considerations for effective Vision & Mission statements
  • 109.
    109 National Overall ReferenceArchitecture (NORA) – Handbook 7.4.2 Step 4.2 Define EA’s architecture principles With the government agency’s vision, mission and architecture objectives defined, the next activity is for the EA Core team to rationalize the architecture principles. While this may sound easy, the definition of these principles should be deeply analyzed and reviewed as it affects the EA development. Architecture principles are statements about high level rules and strict guidelines to shape and steer the development and maintenance of the government agency’s EA. These principles would aid decision making and even architecture designs of the various components in the EA. More importantly, these architecture principles reflect a level of con- sensus on how architecture elements should be abstracted, integrated and used to develop the future or target architectures, and eventually how stakeholders can appreciate the values or outcomes of EA. Table 7-3 are some recommended criteria for the development of good or acceptable architec- ture principles. Criteria Description Easy to Understand The architecture principle should be easy to understand by any person Completeness The architecture principle should be comprehensive in coverage. Typically it would cover both IT and business aspects Consistency The architecture principle should be applied to consistently to all aspects of EA development. It should consistent in its application to all architectures or reference models Robust The architecture principle should be robust to changing environ- ments and circumstances. While there are constant changes like politics, technologies and social demands, the architecture prin- ciple should be able to endure these factors and continue to be relevant Table ‎7-3: Criteria examples of good architecture principles
  • 110.
    110 National Overall ReferenceArchitecture (NORA) – Handbook Figure 7-2 illustrates how EA principles are derived from the EA purpose or value proposition statements. Figure ‎7-2: Example of EA architecture principles The following are the recommended factors for consideration in developing the EA architecture principles: 1. The EA vision and mission statements, and the architecture objectives should drive the architecture principles 2. Alternatively, the EA purpose or value-proposition statements can also be used to derive the architecture principles 3. Refer to other EA frameworks as examples; also refer to NEA architecture principles 4. Brainstorm for the relevant EA architecture principles to aid the EA development and main- tenance. The Enterprise Architect should lead the session 5. Prioritize and document these principles; preferably not more than seven principles.
  • 111.
    111 National Overall ReferenceArchitecture (NORA) – Handbook 7.4.3 Step 4.3 Present and obtain approval for EA vision, mission and ar- chitecture objectives Present the EA vision and mission statements, architecture objectives and architecture principles to the EA Governance Committee. As these are very high-level statements, expect comments from the committee and the need to enhance them to get a final approval. 7.4.4 Step 4.4 Define EA Framework structure The next step is to define an EA Framework structure that outlines the overall ‘look’ of the EA. It describes the boundaries of the EA for the government agency based on the vision and mission statements, architecture objectives and architecture principles that shape the development of the EA. An EA Framework is a structure used for organizing EA elements and their relationships. The EA Framework is used to design and develop the actual government agency’s EA and other reference models. The key activities to develop an EA Framework structure are: 1. Analyze the related trends and case studies for EA for similar government line of business or function (see Table 7-4 as an example). This could be both external and local government agencies. Look at their EA frameworks or conceptual architecture diagrams 2. Also refer to NEA and other government agencies’ EA frameworks 3. Analyze each component in the example EA frameworks and take the relevant components 4. Design the high level based on the need to have the relevant components 5. Review and enhance the EA Framework (this is an iterative process).
  • 112.
    112 National Overall ReferenceArchitecture (NORA) – Handbook Research Item Description National EA Frame- work Standard Provide frameworks and guidelines required for EA development by identifying, organizing national EA framework elements and setting relationships between them EA Demonstration Project Agencies’ EA demonstration projects for EA implementation (Ministry of Information and Communication, Ministry of Govern- ment Administration and Home Affairs, Public Procurement Service, Ministry of Maritime Affairs and Fisheries) Overseas Case Overseas framework cases (FEAF: established and construct reference models according to OMB guideline TEAF: define elements such as architecture framework, governance, process, etc. DOI: the U. S. interior department’s framework) Table ‎7-4: Examples of research areas for EA Framework Figure 7-3 is an example of an EA Framework structure. Government agencies need not follow all of the architectures in the example but the relevant ones to meet the overall EA strategy. Some of the architectures in the example can be added (for example Service Architecture and Process Architecture) or can be replaced (such as Information Architecture instead of Data Architecture).
  • 113.
    113 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎7-3: EA Framework structure example 7.4.5 Step 4.5 Design EA architecture elements With the high level EA Framework structure, the EA Core team can start identifying and defin- ing architecture elements within each architecture boundary. By referring to other related EAs, the EA Core team can make logical relationships and deductions. As the EA Framework has also already established a “Big Box”, this step is to fill the elements within each architecture. These elements will also be the main artifacts – i.e. documents that are created, designed and main- tained as part of EA. The recommended architecture elements are listed below in Table 7-5. The EA Core team can add or remove these elements on a need basis. For each of the following elements, the EA Core team lead by the Chief Architect have to rationalize and describe the architecture elements. Note that this is an iterative process and requires a series of brainstorming and review sessions.
  • 114.
    114 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Element or Artifact Definition 1 Principles Describe the architecture principles of the particular architecture; it has to have more than 1 principle 2 Architecture Element Describe the relevant architecture elements of the particular architecture; it can 1 or more elements 3 Rules and Standards Describe the important rules and standards in developing the architecture; it supports the principles established above 4 Components Describe the components that are related to the architecture elements; typically one archi- tecture element has one or more components 5 Domains Describe the area or scope of architecture implication; typically related to technology domains, each architecture may have 0, 1 or more domains 6 Patterns Describe or illustrate, normally in diagrams, the main architecture patterns that is useful to further develop the actual reference model; typically each architecture has at least one pattern 7 Building Blocks Describe how the relevant elements can be pieced together; it shows the dependency if any Table ‎7-5: Description of EA elements 7.4.6 Step 4.6 Design EA model Having designed the high level EA Framework structure and its architecture elements, the EA Core team has to design the EA Model that is express as a matrix classifying all resources from different views or perspectives. For now, the EA Model is a high-level classification of views and key architectural elements. Subsequently in the EA development, the EA Core team will use this model to develop further detailed reference models. The purpose of the EA Model definition is to establish current / target architecture and a basic system for the management and application of the EA.
  • 115.
    115 National Overall ReferenceArchitecture (NORA) – Handbook S/No Task Method Deliverable 1. Define architecture model’s view and perspective for registering, using, managing EA information a. Perspective definition b. Perspective or viewpoint is divided by a role of EA stakeholders such as CEO, CIO, IT Manager, Architect and IT Developer or Vendor c. Perspective classifies agency’s decision-makings with a hierarchical structure and defines the stages by a decision-making characteristic d. Perspective is defined by roles, not by level or positionAt first, define Perspective by using typical clas- sification, and adjust categories or vocabularies to fit agency’s needs. EA Model by Stake- holder (see Table 7-7) 2. Define architec- ture model’s view and perspective from stakehold- ers’ functional responsibilities a. View definition b. View is a standard for observing architecture’s specific parts. In other word, as to figure out an identical ar- chitecture and, it’s divided by a type of architectural resources c. View is largely divided into busi- ness and technology. While the business is divided into organiza- tion, functions, and projects, the technology is divided into data, application, security, etc. d. In general, one view is taken by a business, and several views are taken by technology components such as data, application, technol- ogy, and security e. National EA framework standard suggests five types of architecture information ㅡ business, data, ap- plication, technology and security. EA Model by Archi- tecture (see Table 7-8)
  • 116.
    116 National Overall ReferenceArchitecture (NORA) – Handbook 3. Define Artifacts Meta-Model a. Define all the key elements or artifacts b. Define the attributes of these ele- ments or artifacts c. Define relationships among ele- ments or artifacts d. Please refer to NEA Meta-Model Draft EA Frame- work with Artifacts Meta-Model 4. Define Artifacts’ Elements a. Define the actual elements and arti- facts b. Define the actual attributes c. Define the actual relationships among the elements or artifacts Draft EA Frame- work with Artifacts and Elements Defi- nitions Table ‎7-6: Activities to develop the EA Model Who Business Application Data Technology Security CEO/CIO Deal with strategy, plan, overall process, key information, main infrastructure, organizational chart IT Manager Deal with business process, information, IT infrastructure Architect Deal with logical business process design, logical information model, component/ application design, system dispersion/ deployment IT Developer / Vendor Deal with integration and tests with considering limitations to tools, technology, and resources Table ‎7-7: EA Model view by stakeholders Who Business Application Data Technology Security CEO/CIO Human resources, goods, places and incidents Business func- tions, process and activities All necessary information and its relationships Hardware, software and network Secu- rity policy or structure IT Manager Architect IT Developer / Vendor Table ‎7-8: EA Model view by architecture
  • 117.
    117 National Overall ReferenceArchitecture (NORA) – Handbook General Recommendations for DefiningViews and Artifacts Make an architecture model best fitted with the government agency’s characteristics. Suggest a list of documents and formats that each business / IT management department manage, and use them. In general, artifacts are constructed with a figure type or a description type. In case there are figure type artifacts, check if description type artifacts are needed, and vice versa. Clearly define artifacts with questions such as: 1. Are specific use purposes for each artifact defined? 2. What do artifacts establish? 3. Why is the artifact required? The following are recommended activities for defining Meta-Model Artifacts: 3. Elements definition a. Artifacts meta-model elements define each element for registering and managing artifacts b. Deduce elements based on agency’s EA Usage planning c. Deduce elements based on agency’s EA development purposes d. Deduce elements best fitted with agency’s EA requirements e. It’s advisable to delete easily changeable information from elements f. Define elements by referring to ‘National EA Artifact Meta-model Definition’ g. The agency should define compulsory items in ‘National EA Artifact Meta-model Definition’. If not, the agency should do a mapping with the national EA items for government’s utiliza- tion. Among the architecture information, consider the mandatory items of mandatory artifacts that should be offered to national EA support system.
  • 118.
    118 National Overall ReferenceArchitecture (NORA) – Handbook 3.Attributes definition a. Define each element’ attributes b. Since they can be basic information of understanding elements, all required attributes should be deduced for EA use c. It’s advisable to delete easily changeable information from attributes. 4. Define a relationship between elements a. Set a relationship by figuring out correlation between elements b. The relationship should be defined correctly since it can be a foundation of understanding the relationship with other elements during artifacts registration / use. The following are activities to define the artifacts / elements and their actual attributes: 1.Artifacts definition i. With reference to EA purpose/ use, define required artifacts for using business/ IT information by each view and perspective ii. Define them by following mandatory artifacts suggested in ‘National EA Artifact Meta-mod- el Definition’ in order to be offered to national EA support system iii. Define the artifact’s elements according to its definition and purposes iv. According to artifacts definition, agency’s artifacts definition, including artifacts definition, purpose, description, templet, example, meta-model, etc., is written v. Can use artifacts naming method to keep their consistency vi. In case required elements for each artifact are same, they can be integrated, defined as one element vii. Write agency’s artifacts definition with reference to National EA Artifact Meta-model Definition’.
  • 119.
    119 National Overall ReferenceArchitecture (NORA) – Handbook 2. Define a relationship between artifacts a. Can define a relationship between artifacts by figuring out their attributes b. Identify the relationship by defining the relationship between elements c. Check how artifacts are aligned, especially between business and IT d. Through this step, can Identify missing or necessary relationships between elements and add them. 7.4.7 Step 4.7 Develop EA documentation standard To complete the whole EA Framework, it is a good practice to develop an EA Documentation Standard. The objective is to ensure consistent quality in the production and maintenance of EA artifacts and documents. The following steps are recommended: 1. Adopt the government agency’s standard documentation template; if this is not available, then create one 2. Standardize on the written format such as page size, fonts, table-of-content, header & footer and paragraphing (e.g. 1.5 line of space, full-justified) 3. Standardize on EA and government agency’s terms and terminologies; Table 7-9 below is an example of Yesser’s documentation standard for terms 4. Standardize on the choice of tool to produce diagrams and figures (as EA will produce many diagrams) such as Visio 5. Standardize on the process for creating, updating, versioning, reviewing and approving these artifacts and documents.
  • 120.
    120 National Overall ReferenceArchitecture (NORA) – Handbook S/No Yesser Standard Terms Comment 1 e-Government Program (Yes- ser) Use the full terms for first definition in the documentation; subsequently use ‘Yesser’ 2 e-Government Describes general e-Government 3 e-service Describes general e-service 4 The 2nd e-Government Action Plan The name of the current action plan for 2013-2017 5 e-transformation Describes the general transformation route from a traditional government into an electronic government 6 YeFI Yesser Framework For Interoperability 7 e-Government National Portal The initiative for one standard government national portal 8 e-Government Data Center The initiative for a central government data center 9 Government Secure Network (GSN) The initiative for one government secure network 10 Government Service Bus (GSB) The initiative for government to exchange data and information 11 National Center for Digital Certification The initiative to implement national Pubic Key Infrastructure (PKI) 12 Single Sign-On (SSO) The initiative to implement one standard authentication mech- anism to access government services 13 SADAD Payment System (SA- DAD in short) The initiative to implement standard national billing and payment system 14 e-Channel(s) Describes the method of interaction between service pro- vider and consumer (e.g. Web, Mobile Application and Kiosk) 15 e-Training Describes interactive online training delivery 16 government agency Refers to the general government ministries, authorities, boards, councils, etc. Table ‎7-9: Example of Yesser’s standard terms
  • 121.
    121 National Overall ReferenceArchitecture (NORA) – Handbook 7.4.8 Step 4.8 Develop EA artifacts management processes As there will be many artifacts and documents produced in the course of the EA development, it is necessary to have a standard management process to review and approve the various documents. Please refer to the section Continuous Governance – where the artifact process management are describe as part of the EA overall change management – for more details. The team needs to develop all the relevant artifacts management processes. 7.4.9 Step 4.9 Present and obtain approval for EA framework With the completion of the EA Framework with the other above related contents, present to the EA Governance Committee. The Chief Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 122.
    122 National Overall ReferenceArchitecture (NORA) – Handbook AboutReference Models&Architectures
  • 123.
    123 National Overall ReferenceArchitecture (NORA) – Handbook 8. About Reference Models & Architectures 8.1 Need for clarity In the next few stages, the government agency will build reference models and architectures. However, before building them, it is important to understand the differences among the vari- ous reference models, current and target architectures. The EA Core team and working team members have be clear about these deliverables and their respective objectives or purposes. In addition, it would help to understand the relationships among these different deliverables. 8.2 Definitions The following are the main definitions: 1. Reference Model From The Open Group Architecture Foundation (TOGAF): “A reference model is an abstract framework for understanding significant relationships among the entities of [an] environment, and for the development of consistent standards or specifica- tions supporting that environment. A reference model is based on a small number of unifying concepts and may be used as a basis for education and explaining standards to a non-specialist.” A reference model specifies standard classification and definition of common components used for developing EA. EA reference model defines a set of standard representations and specifica- tions to be use for developing EA, ensuring consistency, uniformity, and interoperability with reference to NEA reference model. In short, a reference model is use to describe, show and explain in general terms the main archi- tectural elements or components so that different stakeholders can reference it to understand and make relevant decisions that apply to their local context.
  • 124.
    124 National Overall ReferenceArchitecture (NORA) – Handbook There are two main reference models in EA – NEA Reference Model and Government Agency Reference Model. 2.Architecture TOGAF defines an architecture as follows: a A formal description of a system, or a detailed plan of the system at component level, to guide its implementation (source: ISO/IEC 42010:2007). b. The structure of components, their inter-relationships, and the principles and guidelines governing their design and evolution over time. In EA, the architecture describes the relevant elements or components from the reference model, and further designs the details based on available data and circumstances to meet the architectural objectives. 3. Difference between Reference Model and Architecture One analogy is like city planning. The National Enterprise Architecture (NEA) reference model describes the overall city plan. By referencing it, each government agency will know which part of the city and what buildings it need to build. The government agency can then develop its own specific building reference model where it will give more details to the building designs. From its reference model, the government agency can architecture its current buildings (with more details like office layout, gardens, parking areas, security offices, masjid and reception office). On the other hand, the target architecture will show how the buildings will be transform in the future with the respective details. Table 8-1 provides the respective descriptions of the various reference models and architectures.
  • 125.
    125 National Overall ReferenceArchitecture (NORA) – Handbook S/No EA Artifact Description 1. NEA Reference Model Saudi government-wide reference model for all government agencies. It gives the consolidated government-wide model of the key IT and business objects and their relationships. 2. Agency Reference Model Specific view of the NEA Reference Model for the government agency only. It provides the government agency’s model of its IT and business objects in relation to the NEA Reference Model. 3. Agency Current Architecture Description and design of the current IT and business landscape. It shows all the actual current IT, business objects, and their relationships. 4. Agency Target Architecture Description and design of the target or future IT and business landscapes. It shows all the future IT and business objects and their relationships after changes made to the current architecture (i.e. additions, dele- tions and modifications of the current IT and business objects). Table ‎8-1: Differences between Reference Models and Architectures 8.3 Process to build reference models and architectures In the next few stages, the government agency will build reference model and architectures in succession. This section, however, aims to provide a comprehensive view about the building process and the inter-relationships among these deliverables. The basic process to develop these deliverables are as follows: 1. Build agency reference models By referring to the NEA reference models, the government agency has to build its own reference models. The objective is to analyze from the whole-of-government models, take the appropriate and relevant context, and build the required architecture elements for the government agency.
  • 126.
    126 National Overall ReferenceArchitecture (NORA) – Handbook 2. Build current architectures From the government agency’s reference models, the EA Core and working teams have to gather information to reflect the current state of the IT and business landscapes. The outcomes will describe the government agency’s relevant current architectures. In addition, the government agency has to analyze and plan for improvements or ways to overcome current challenges and limitations. 3. Build target architectures The government agency has to develop target outcomes or goals that will drive the design of the future target architectures. Figure 8-1 summarizes the basic process in building these reference models and architectures. Figure ‎8-1: Basic process in building reference models and architectures
  • 127.
    127 National Overall ReferenceArchitecture (NORA) – Handbook 8.4 Building blocks of reference models and architectures The building blocks or components for NEA reference models, agency reference models and architectures are similar. Figure 8-2 illustrates the main components in each model or architecture. The EA Framework developed in the previous stage would also be similar in terms of the components. Figure ‎8-2: Building blocks / components Each model or architecture would minimally describe the following: 1. Purpose & Direction The purpose statement describes what the model or architecture does. It is specific and normally measurable. The direction statement describes the main delivery focus; it affects the scope of the model or architecture. 2. Principles These are architectural principles for the model or architecture development. Each principle pro- vides specific scope and reason the development of the model or architecture. As a guideline, the number of principles should not exceed seven.
  • 128.
    128 National Overall ReferenceArchitecture (NORA) – Handbook 3.Artifacts These are actual deliverables or outcomes of the model or architecture. The artifact name has to match with the definitions and names in the EA Meta Model. The number of artifacts com- monly range from 4 to 10 in each model or architecture. NEA consists of five reference models as shown in the figure below. Each model has the same building blocks or components. Government agencies have to apply the same building blocks or components in developing their own reference models and architectures in the next few stages. Figure ‎8-3: Same building blocks in NEA reference models
  • 129.
    129 National Overall ReferenceArchitecture (NORA) – Handbook 8.5 Summary of deliverables for reference models and architectures The table below lists the important deliverables or artifacts to be produce in the government agencies’ reference models and architectures. Domain NEA Reference Model Artifacts Agency Reference Model Artifacts Agency Current Ar- chitecture Artifacts Agency Target Ar- chitecture Artifacts Performance Performance Reference Model Comprising of: 1. Purpose / Direction 2. PRM Principles 3. Strategic Goals 4. Performance Goals 5. Measurement Areas 6. Measurement Cat- egories 7. Measurement Groups 8. Indicators Performance Reference Model 1. Comprising of: 2. Purpose / Direction 3. PRM Principles 4. Strategic Goals 5. Performance Goals 6. Measurement Areas 7. Measurement Cat- egories 8. Measurement Groups 9. Indicators N.A. N.A, The performance measurement indicators will be embedded in the various target architec- tures Business Business Reference Model Comprising of: 1. Purpose / Direction 2. BRM Principles 3. Business Area 4. Line of Business (LoB) 5. Business Function Business Reference Model Comprising of: 1. Purpose / Direction 2. BRM Principles 3. Business Area 4. Line of Business (LoB) 5. Business Function 6. Sub-Business Function Purpose / Direction 1. BA Principles 2. Agency BRM 3. Organizational Chart 4. Business Function 5. Business Processes 6. Service Catalogue Purpose / Direction 1. BA Principles 2. (reviewed / updated) 3. Organizational Chart (reviewed / updated) 4. Business Function (reviewed / updated) 5. Business Processes (improved) 6. Service Catalogue (updated)
  • 130.
    130 National Overall ReferenceArchitecture (NORA) – Handbook Domain NEA Reference Model Artifacts Agency Reference Model Artifacts Agency Current Ar- chitecture Artifacts Agency Target Ar- chitecture Artifacts Application Application Reference Model Comprising of: 1. Purpose / Direction 2. ARM Principles 3. Application Sys- tems 4. Application Com- ponents 5. Application Inter- faces 6. Best Practices and Guidelines 7. Application Systems for Saudi Government 8. List of National Shared Application Systems Application Reference Model Comprising of: 1. Purpose / Direction 2. ARM Principles 3. Application Systems 4. Application Compo- nents 5. Application Interfaces 6. Prioritized List of Ap- plication Systems Purpose / Direction AA Principles Agency ARM Application Overview Application Catalogue Application Functions Application Relationships Application Consolidation Plan (optional) Purpose / Direction AA Principles (reviewed / updated) Application Overview (updated) Application Catalogue (updated) Application Functions (updated) Application Relation- ships (updated) List of Agency Shared Application Systems and Components (optional) Data Data Reference Model Comprising of: Purpose / Direction DRM Principles National Data Model Data Classification Data Structure Data Exchange Data Management List of National Shared Data Services Data Reference Model Comprising of: Purpose / Direction DRM Principles Conceptual Data Model Data Classification Data Structure Data Exchange Data Management Purpose / Direction DA Principles Agency ARM Conceptual Data Model Logical Data Model Data Flow Diagram Database Portfolio Cata- logue Data dictionary Data Consolidation Plan (optional) Purpose / Direction DA Principles (re- viewed / updated) Conceptual Data Model (updated) Data Management (updated) Logical Data Model (updated) Data Flow Diagram (updated) Database Portfolio Cata- logue (updated) Data dictionary (up- dated) List of Agency Shared Data Services (optional)
  • 131.
    131 National Overall ReferenceArchitecture (NORA) – Handbook Domain NEA Reference Model Artifacts Agency Reference Model Artifacts Agency Current Ar- chitecture Artifacts Agency Target Ar- chitecture Artifacts Technology Technology Reference Model Comprising of: Purpose / Direction TRM Principles Service Area Service Category Service Standards Technology Reference Model Comprising of: Purpose / Direction TRM Principles Service Area Service Category Service Standards Purpose / Direction TA Principles Agency TRM IT Infrastructure Overview IT Infrastructure Descrip- tion Hardware Catalogue Software Catalogue Purpose / Direction TA Principles (re- viewed / updated) IT Infrastructure Over- view (updated) IT Infrastructure Description (updated) Hardware Catalogue Software Catalogue List of Agency Shared Infrastructure Services (optional) Table ‎8-2: Summary of artifacts by reference models and architectures
  • 132.
    132 National Overall ReferenceArchitecture (NORA) – Handbook Stage5–Build ReferenceModels
  • 133.
    133 National Overall ReferenceArchitecture (NORA) – Handbook 9. Stage 5 – Build Reference Models 9.1 Stage summary The previous section has defined and described the reference models and architectures. Based on the EA framework developed previously, this stage is all about building the reference models so that a government agency can have standard views and taxonomies of key organizational assets and processes such as business, application, data and technology domains. 9.2 Stage purpose The purpose of stage 5 is to architect and build the relevant EA reference models of the government agency. The following specific expected outcomes from this stage are: 1. Performance Reference Model 2. Business Reference Model 3. Application Reference Model 4. Data Reference Model 5. Technology Reference Model. Note that the above are recommended outcomes. A government agency can have more or less, or even combine reference models depending on its EA requirements, its EA framework design and its EA goals. Other examples of reference models are security reference model, service reference model and infrastructure reference model. 9.3 Stage initiation This stage requires the EA vision, mission, architecture goals & principles, and the EA framework from the previous stage. In addition, the government agency needs to refer to Yesser’s NEA Reference Models. By referring to the NEA reference models, the government agency can de- velop their own reference models ensuring alignment with whole of government as well as to achieve its EA goals.
  • 134.
    134 National Overall ReferenceArchitecture (NORA) – Handbook 9.4 About NEA reference models Since the government agencies have to refer to NEA reference models, it is a pre-requisite to understand all the five reference models and their inter-relationships. The objectives or goals of the NEA reference models are: 1. To provide whole-of-government structured information on IT and business landscapes 2. To provide effective views or perspectives for different stakeholders in the government – from business to applications to data to IT infrastructure 3. To provide a reference point for government agencies to review and distill relevant informa- tion and design for their own use. Figure 9-1 illustrates the NEA reference models and their inter-relationships. Figure ‎9-1: NEA reference models and their inter-relationships
  • 135.
    135 National Overall ReferenceArchitecture (NORA) – Handbook a. Performance Reference Model The Performance Reference Model (PRM) is an outcome-focused measurement framework that can assist government agencies in the design and implementation of effective business measurement systems and performance architectures. The PRM, through the measurement indicators, sets the performance standards for the government. Hence, from an architectural viewpoint, the PRM sets the performance standards for the other four reference models. b. Business Reference Model The Business Reference Model (BRM) is a classification category used to describe the type of business functions for the whole of Saudi government. It gives a logical functional view instead of functions by physical government agencies. The functions and requirements in BRM drives the other reference models, i.e. Application Reference Model, Data Reference Model and Tech- nology Reference Model. c.Application Reference Model The Application Reference Model (ARM) is a categorization of different types of application systems, application components and interfaces. It is the framework for categorizing national shared IT systems and application components to help identify opportunities for sharing, reuse, and consolidation or renegotiation of software licenses. The ARM supports directly the BRM in delivering the business outcomes. d. Data Reference Model The DRM (Data Reference Model) is a model that classifies data and defines a standard data structure to support developing data architecture and promoting data standardization/reuse/ management. The DRM supports the ARM directly in delivering business goals by supplying data and information. The various application systems have to use data to provide information to the businesses. e.Technology Reference Model The Technology Reference Model (TRM) classifies and defines technologies and technology standards/specifications that support businesses and services. Under structured technology classifications, technology standards are define to promote inter-operability among govern- ment agencies. The TRM supports the data usage in DRM, supports application systems in ARM through the technology definitions and infrastructure implementations, and supports the agen- cy staff through use of personal and office technologies. Please refer to the actual NEA reference models for details.
  • 136.
    136 National Overall ReferenceArchitecture (NORA) – Handbook 9.5 Key steps in stage 5 Stage 5 is all about building the relevant reference models. Table 9-1 lists all the key steps in Stage 5. Stage / Step No Description Deliverable 5 Document Government Agency’s Reference Models Government Agency’s Reference Models 5.1 Develop a model that standardizes performance elements for improving IT projects and their quality. Obtain approval from the EA Governance Committee Approved Performance Reference Model 5.2 Develop a model that classifies and defines busi- ness functions and related information. Obtain approval from the EA Governance Committee Approved Business Reference Model 5.3 Develop a model that classifies and defines shared application systems/components to pro- mote service integration and reuse by identifying redundant or correlated applications. Obtain ap- proval from the EA Governance Committee Approved Application Reference Model 5.4 Develop a model that classifies data and defines standard data structures to support data architecture development, data standard, and data reuse. Obtain approval from the EA Governance Committee Approved Data Reference Model 5.5 Develop a model that classifies and defines technologies and technology standards/speci- fications, which support business and services. Obtain approval from the EA Governance Com- mittee Approved Technology Reference Model Table ‎9-1: Stage 5 steps In building the various agency’s reference models, the EA Core and working teams have to make reference to its EA Framework (developed in Stage 4) and NEA Reference Models.
  • 137.
    137 National Overall ReferenceArchitecture (NORA) – Handbook 9.5.1 Step 5.1 Build performance reference model The Performance Reference Model (PRM) is an outcome-focused measurement framework that can assist government agencies in the design and implementation of effective business measure- ment systems and performance architectures. It is made up of an hierarchical model that helps identify measurement needs; a classification framework that describes the types of measurement that can support the identified needs; and a measurement framework that helps define effective measurement indicators. NEA PRM Figure 9-2 shows the NEA PRM artifacts while Table 9-2 describes the artifacts or deliverables. Government agencies have to refer and understand the NEA PRM artifacts and contents. Please refer to the PRM details and consult NEA office for clarification or discussion. Figure ‎9-2: NEA PRM artifacts
  • 138.
    138 National Overall ReferenceArchitecture (NORA) – Handbook S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of PRM 2 PRM Principles The architectural principles of PRM 3 Strategic Goals / Outcomes The highest level strategic outcomes for Saudi government 4 Performance Goals The specific performance goals in certain areas and / or over certain time period for Saudi government 5 Measurement Areas The various broad areas for measurement 6 Measurement Categories The various categories for measurement within a measurement area 7 Measurement Groups The various groups for measurement within a measurement category 8 Indicators The actual measurement indicators Table ‎9-2: PRM artifact descriptions Relationship between NEA PRM and Agency PRM The NEA PRM describes the reference for whole-of-government performance standards. By referencing the NEA PRM, a government agency can extract the relevant scope that is applicable. Hence, the agency PRM is like a sub-set of the NEA PRM and the diagrams for both NEA PRM and agency PRMs are the same. However, the agency PRM has to describe more detail performance indicators for the government agency within the same measurement categories and groups. At the same time, the agency PRM has to align with the NEA PRM in terms of the high-level strategic goals and measurement areas. Building the Agency PRM Table 9-3 summarizes the main activities for building the agency PRM.
  • 139.
    139 National Overall ReferenceArchitecture (NORA) – Handbook S/No Activity Artifact / Deliverable 1 Define the PRM purpose or direction PRM purpose / direction statement 2 Define the PRM principles PRM principles 3 Define the Strategic Goals and Perfor- mance Goals Strategic goals and performance goals for agency 4 Define the Measurement Areas, Catego- ries, Groups and Indicators Set of indicators within measurement groups within measurement categories within measurement areas 5 Document and review the draft PRM Reviewed draft PRM 6 Obtain governance approval Approved agency PRM Table ‎9-3: Main activities to build agency PRM 1. Define the PRM purpose or direction Depending on the actual EA scope for the government agency, it has to define the appropriate PRM purpose or direction. The government agency can refer to the NEA PRM’s purpose or goals to further refine or localize its purpose. The figure below shows an example of the PRM purpose and direction. Figure ‎9-3: Example PRM purpose and direction
  • 140.
    140 National Overall ReferenceArchitecture (NORA) – Handbook 2. Define the PRM principles Refer to NEA PRM principles to adopt and adapt for the government agency’s own PRM principles. Note that good principles would aid or direct the subsequent development work of the PRM. As a guide, there should not be more than seven principles. 3. Define the Strategic Goals and Performance Goals From the NEA PRM’s strategic goals, identify the relevant goals that are directly applicable to government agency. For each of the strategic goals identified, adapt it into local agency context that will become the agency’s strategic goals. If need be, refer to the government agency’s strat- egy / annual plans and royal decrees if any. It would also be effective to illustrate the strategic goals and performance goals in a diagrammatic form as shown below. Figure ‎9-4: Example PRM strategic goals / outcomes
  • 141.
    141 National Overall ReferenceArchitecture (NORA) – Handbook 4. Define the Measurement Areas, Categories, Groups and Indicators The next few activities are inter-related. With reference to NEA PRM, analyze and localize the measurement areas, categories, groups and indicators. The measurement areas refer to the highest level in the government agency. Typically, these measurements can derive from Mission, Vision and highest level PKIs. Examples of measure- ment areas are Customers / Public, Investments, Expenditures, Employees, Technologies and Assets. For each area, drill down to define the measurement categories such as financial, HR, customer service and IT. The next step is to define the measurement groups such as division, branch, department, unit and team. It is advisable to develop progressively evaluation indicators for a specific group since it is dif- ficult to do all at once. Table 9-4 shows examples of measurement indicators. Measure- ment Area Measurement Category Indicator S/No Indicator Defini- tion Measurement Method Measurement Indi- cator Customer Customer Satisfaction C.1 Satisfaction response by customer Immediately after service by pressing Satisfaction Rating button % of satisfaction by Very Good, Good, OK, Bad, Very Bad C.2 Average time to process cus- tomer’s inquiry Survey to random sampling of customers Number of hours Technol- ogy IT Service Request T.1 Number of Processed IT Request Calculate number of processed IT requests to total requests received % of processed IT request New Tech- nologies T.2 Number of New Technologies Adopted Number over the year Number of new technologies Table ‎9-4: Example measurement areas, categories and indicators
  • 142.
    142 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎9-5: Example of PRM indicator description 5. Document and review the draft PRM After all the definitions, document all the relevant information into a structured information base on the agency’s documentation standards. Do an internal review and updates. It is also advisable to get another party to carry out a final review. 6. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect or Business Architect should front this presen- tation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 143.
    143 National Overall ReferenceArchitecture (NORA) – Handbook 9.5.2 Step 5.2 Build business reference model The Business Reference Model (BRM) is a classification category used to describe the type of business functions at the government agency, in a given sector or national levels. BRM focuses on categorizing a business base on structured business elements such as business area, line of business and business functions perform by the government agency. NEA BRM Figure 9-6 shows the NEA BRM artifacts while Table 9-5 describes the artifacts or deliverables. Government agencies have to refer and understand the NEA BRM artifacts and contents. Please refer to the BRM details and consult NEA office for clarification or discussion. Figure ‎9-6: NEA BRM artifacts
  • 144.
    144 National Overall ReferenceArchitecture (NORA) – Handbook S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of BRM 2 BRM Principles The architectural principles of BRM 3 Business Areas The highest abstract groupings of business for Saudi government 4 Lines of Business The broad logical groupings of business for Saudi government (instead of definitions by physical agencies) 5 Business Functions The main business functions within each Line of Business 6 Sub-Business Functions The finer-grain business functions within each business function Table ‎9-5: BRM artifact descriptions Definitions The following are the main definitions for common understanding: Business Area A Business Area is the collection of the highest abstraction description of related government’s accountabilities to the different stakeholders such as the Royal Family, citizens, businesses and internal governments. Line of Business (LoB) An LoB is a broad collection of government roles and responsibilities (both primary and sec- ondary) within a Business Area. The LoB’s perspective is from a role or responsibility, and not by government agency. Business Function A Business Function is a set of work to be carry out to accomplish the roles and responsibilities described in the LoB. Each LoB has two or more business functions.
  • 145.
    145 National Overall ReferenceArchitecture (NORA) – Handbook Sub-Business Function A Sub-Business Function is a set of physical activities to be carry out to complete the work defined in the business function. A Business Function has two or more sub-business functions. Relationship between NEA BRM and Agency BRM The NEA BRM describes the reference for whole-of-government business. By referencing the NEA BRM, a government agency can understand how it relates to the different line of business (LoB) under different business areas. By extracting the relevant business scope that is applicable, the agency can develop its own BRM. Hence, the agency BRM is like a sub-set of the NEA BRM (the diagram for agency and NEA BRMs are the same). However, the agency BRM has to describe more detail business functions and sub-business functions for the government agency within each LoBs. Through such definitions, the agency BRM will align with the NEA BRM in terms of the high-level business areas and line of business. Building the Agency BRM Below table summarizes the main activities for building the agency PRM. S/No Activity Artifact / Deliverable 1 Define the BRM purpose or direction BRM purpose / direction statement 2 Define the BRM principles BRM principles 3 Define the Business Areas, Lines of Busi- ness (LoB), Business Functions and Sub- Business Functions List of related business areas, LoBs, business function and sub-business function descriptions 4 Document and review the draft BRM Reviewed draft BRM 5 Obtain governance approval Approved agency BRM Table ‎9-6: Main activities to build agency BRM
  • 146.
    146 National Overall ReferenceArchitecture (NORA) – Handbook 1. Define the BRM purpose or direction Depending on the actual EA scope for the agency, define the BRM purpose or direction. In addition to improving overall effectiveness, the agency BRM typically gives an insight into the actual accountabilities, roles, key functions and relationships with other government agencies. The BRM is also an excellent tool to aid e-Government transformation. It is also necessary to refer to the agency PRM and incorporate relevant strategic goals and measurements into the BRM. The figure below gives an example purpose or direction for BRM. Figure ‎9-7: Example BRM purpose 2. Define the BRM principles Refer to NEA BRM principles to adopt and adapt for the government agency’s own BRM principles. Note that good principles would aid or direct the subsequent development work of the BRM. As a guide, there should not be more than seven principles. 3. Define the Business Areas, Lines of Business (LoB), Business Functions and Sub-Business Functions This step has a few inter-related activities that is best done collectively in an hierarchical way. Refer to NEA BRM and do the following: a. Find the related business areas that the agency has accountabilities or responsibilities b. Similarly, for each business area identified, find the LoBs for the agency. Please note that the BRM is a logical representation of responsibilities. Thus, it is common that an agency is involve in at least two LoBs c. For each LoB, find all the related business functions d. Finally, for each business function, find all the sub-business functions carry out by the agency.
  • 147.
    147 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎9-8: Example of business area, LoB, business function and sub-business functions The figure above illustrates the relationship and information on the various business artifacts or descriptions for Ministry of Education (MoE). This is only an example and does not fully depict the actual case for MoE. For the same example, the information can also be shown in the table below.
  • 148.
    148 National Overall ReferenceArchitecture (NORA) – Handbook Business Area Line of Business Business Function Sub-Business Function Royal Family Affairs Not listed Not listed Not listed Citizen Services Education Pre-School to High-School Education 1. Curriculum Planning for Schools 2. School Administration and Governance Graduate and Post-Graduate Education 1. Curriculum planning for universities 2. Accreditation Business Services Licensing & Regulatory Control Licensing & Regulatory Con- trol of Private Schools 1. Registration and Com- munication with Private Kindergartens & Schools 2. Licensing Management 3. Regulatory Enforcement Government Services Not listed Not listed Not listed Table ‎9-7: Example of business area, LoB, business function and sub-business functions 1. Document and review draft BRM After listing all the definitions, document the relevant information into a structured information base on the agency’s documentation standards. Do an internal review and updates. It is also advisable to get another party to carry out a final review. 2. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect or Business Architect should front this presentation. From the comments from the committee, make the necessary changes to ob- tain their final approval.
  • 149.
    149 National Overall ReferenceArchitecture (NORA) – Handbook 9.5.3 Step 5.3 Build application reference model The Application Reference Model (ARM) is a categorization of different types of application systems, application components and interfaces. It is the framework for categorizing national shared IT systems and application components to help identify opportunities for sharing, reuse, .and consolidation or renegotiation of SW licenses NEA ARM Figure 9-9 shows the NEA ARM artifacts while Table 9-8 describes the artifacts or deliverables. .Government agencies have to refer and understand the NEA ARM artifacts and contents Figure ‎9-9: NEA ARM artifacts
  • 150.
    150 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Artifact / Deliverable Description 1 Purpose / Direction The purpose of ARM 2 ARM Principles The architectural principles of ARM 3 Application Systems The application systems to support business. It can be classified as a core application system or a supporting application system 4 Application Components The key application component classifications and descriptions 5 Application Interfaces The common methods or interfaces to connect among applications 6 Best Practices & Guidelines The common best practices and guidelines for development and implementation of application systems, components and interfaces 7 Application Systems for Saudi Government The guide for choosing and prioritizing applications systems for government agencies Table ‎9-8: ARM artifact descriptions The figure below illustrates the structured diagram of NEA ARM. It shows the classifications of the supporting application systems, application components and interfaces. Please refer to the ARM details and consult NEA office for clarification or discussion.
  • 151.
    151 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎9-10: Structured diagram of application systems, components and interfaces in NEA ARM Relationship between NEA ARM and Agency ARM The NEA ARM describes the reference for whole-of-government application systems development. By referencing the NEA ARM, a government agency can understand the structure and classifications applications systems, components and interfaces. The NEA ARM also describes the common application systems for use in government supporting business functions. There is also a best practices and guidelines on application development and maintenance so that government agencies can develop quality application systems. Finally, the NEA ARM guides government agencies in choosing and prioritizing their application development.
  • 152.
    152 National Overall ReferenceArchitecture (NORA) – Handbook The agency ARM, on the other hand, describes the main application systems (core and supporting), components and interfaces for development and implementation specifically for the agency. These application systems have to support the businesses as defined in the agency BRM. In addition, the agency BRM would have a prioritized list of application systems for development. The agency ARM structure is shown in the figure below. The agency ARM has to ensure alignment with the NEA ARM in terms of the high-level application system and component classifications. Figure ‎9-11: Agency ARM artifacts
  • 153.
    153 National Overall ReferenceArchitecture (NORA) – Handbook Building the Agency ARM Below table summarizes the main activities for building the agency ARM. S/No Activity Artifact / Deliverable 1 Define the ARM purpose or direction ARM purpose / direction statement 2 Define the ARM principles ARM principles 3 Define the application systems List of core and supporting application system descriptions for the agency 4 Define the application components List of key application component descriptions 5 Define the application interfaces List of key application interface descriptions 6 Prioritize the application systems List of prioritized application systems for devel- opment 7 Document and review Reviewed draft ARM 8 Obtain governance approval Approved agency ARM Table ‎9-9: Main activities to build agency ARM 1. Define the ARM purpose or direction Depending on the EA scope of the agency, the EA Core and working teams have to discuss and agree on the ARM purpose or direction. It is also necessary to refer to the agency PRM and in- corporate relevant strategic goals and measurements into the ARM. Below is an example of an ARM purpose or direction statement. Figure ‎9-12: Example ARM purpose or direction
  • 154.
    154 National Overall ReferenceArchitecture (NORA) – Handbook 2. Define the ARM principles Refer to the NEA ARM principles as shown below. A good set of principles will aid the development of the agency ARM. Review and customize the appropriate principles for the agency ARM. As a guide, do not have more than seven principles. S/ No Principle Description 1 Strategic Driven Applications Design and prioritize application systems that deliver strategic outcomes. 2 Cross-Agency Application Systems Design and develop application systems that serve multiple government agencies. 3 Easy-to-Use yet Secured Application Systems Design and develop application systems that are easy- to-use and, at the same time, highly secured. 4 Adaptable and Reusable Application Systems & Components Design and develop application systems using reusable components and systems while being adaptable to the constant changes. 5 Vendor-Neutral Application Systems Design and develop vendor-neutral application systems. Table ‎9-10: NEA ARM principles 3. Define the application systems The agency has to define the application systems into core and supporting. As application systems are required to support the business, the EA Core and working teams must refer to the agency BRM. Each business function should be supported by at least one application system. The team should then review the sub-business function and rationalize if the same application system can be support that sub-business function; if not, then another specific application system may be required for the sub-business function.
  • 155.
    155 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎9-13: Example of MOE’s business and sub-business functions In the example above, under Education LoB, MOE requires at least two applications to support the ‘Pre-School to High School Education’ and the ‘Graduate and Post-Graduate Education’. However, it is not practical to have one system to support the two sub-business functions – i.e. ‘Curriculum Planning for Schools’ and ‘School Administration & Governance’ as they are rather varied functional requirements. Thus, MOE requires at least two application systems under the Pre-School to High School Education. Similarly, MOE requires another two application systems to support the two sub-business processes under ‘Graduate and Post-Graduate Education’. In the same token, MOE will have a list of application systems to support the common business functions or sub-business functions such as finance management, IT management, corporate planning & development, and building management among others. The EA Core and working teams must also identify the potential application system owner. If the government agency is the primary owner of the business or sub-business function, then the agency has to develop the identified core application. However, if the agency plays a secondary or supporting function to the business function, then the agency should use the application system developed by the primary agency. Thus, by now, the government agency should have a clear list of what application systems it has to own and develop, and what are the applications it should use from the other primary government agencies.
  • 156.
    156 National Overall ReferenceArchitecture (NORA) – Handbook 4. Define the application components NEA ARM has defined the main application component classifications. Please review them all. In most cases, the agency should adopt all these application components as they are generic yet useful. In addition, review and add other application components to aid the development of the agency’s applications. Al these application components should and can be re-use or shared. 5. Define the application interfaces Like the pervious step, review the list of the common shared application interfaces developed by Yesser. The government agency should be able to adopt most of the application interfaces. Similarly, review and add other specific application interfaces required. 6. Prioritize the application systems Refer to the NEA ARM ‘Application Systems for Saudi Government’ section. Follow the steps to help the government agency prioritize its application systems. At the end of this process, the government agency would have different lists with different priorities for application system development. 7. Document and review After listing all the prioritized application systems, components and interfaces, document the rel- evant information into a structured information base on the agency’s documentation standards. It is recommended to map out the relationship between the application systems and the business or sub-business functions. Do an internal review and updates. It is also advisable to get another party such as business / application owners to carry out a final review. 8. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect or Application Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 157.
    157 National Overall ReferenceArchitecture (NORA) – Handbook 9.5.4 Step 5.4 Build data reference model The Data Reference Model (DRM) is a model that classifies data and defines a standard data structure to support developing data architecture and promoting data standardization / re- use / management. The DRM gives a standard data classification for all the data use in the government agency, including the data sources and the data relationships. NEA DRM Figure 9-14 shows the NEA DRM artifacts while Table 9-11 describes the artifacts or deliver- ables. Government agencies have to refer and understand the NEA DRM artifacts and contents. Figure ‎9-14: NEA DRM artifacts
  • 158.
    158 National Overall ReferenceArchitecture (NORA) – Handbook S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of DRM 2 DRM Principles The architectural principles of DRM 3 National Data Model The data model for KSA government 4 Data Classification The major data classifications 5 Data Structure The overall data structure 6 Data Exchange The common methods for data exchange 7 Data Management The guide for data management for agencies Table ‎9-11: DRM artifact descriptions The figure below illustrates the overall NEA DRM. It provides descriptions of the various arti- facts. Please refer to the DRM details and consult NEA office for clarification or discussion. Figure ‎9-15: NEA DRM
  • 159.
    159 National Overall ReferenceArchitecture (NORA) – Handbook Relationship between NEA DRM and Agency DRM The NEA DRM provides the reference for whole-of-government data usage and standardization. By referencing the NEA DRM, a government agency can understand the high-level data model, data classification, data structure and data exchange. The NEA DRM also provides the data man- agement guide for quality and reliable data usage and exchange. On the other hand, the agency DRM describes the main data model for its own use based on the NEA DRM artifacts. The agency DRM will have its own agency data model, data classification, data structure and data exchange. The agency DRM structure is shown in the figure below. The agency DRM has to ensure alignment with the NEA DRM in terms of the data model, data clas- sification, data structure and data exchange. Figure ‎9-16: Agency DRM artifacts
  • 160.
    160 National Overall ReferenceArchitecture (NORA) – Handbook Building the Agency DRM Below table summarizes the main activities for building the agency DRM. S/No Activity Artifact / Deliverable 1 Define the DRM purpose or direction DRM purpose / direction statement 2 Define the DRM principles DRM principles 3 Define the data model Data model for agency 4 Define the data classifications Key data classifications for agency 5 Define the data structure Main data structure for agency 6 Define the data exchanges Data exchanges for agency 7 Document and review Reviewed draft DRM 8 Obtain governance approval Approved agency DRM Table ‎9-12: Main activities to build agency DRM 1. Define the DRM purpose or direction Depending on the EA scope of the agency, the EA Core and working teams have to discuss and agree on the DRM purpose or direction. It is important to scope carefully the DRM, as it can potentially be very wide. It is also necessary to refer to the agency PRM and incorporate relevant strategic goals and measurements into the DRM. Below is an example of a DRM purpose or direction statement.
  • 161.
    161 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎9-17: Example for defining DRM purpose 2. Define the DRM principles Refer to the NEA DRM principles. A good set of principles will aid the development of the agency DRM. Review the NEA DRM principles and customize the appropriate principles for the agency DRM. As a guide, do not have more than seven principles. 3. Define the data model The objective of a data model is to show data in a logical and structured method that aid data discovery and data re-use. It provides the overall view of all the different architectural data components in a structured fashion. By referring to the NEA DRM, each government agency can identify which data are established and operational at the national level. Similarly, the agency has to build its data model to depict operational data used in the agency. Develop a similar data model for the government agency. The data model would have data classifications, data structure and data exchanges.
  • 162.
    162 National Overall ReferenceArchitecture (NORA) – Handbook 4. Define the data classifications The amount of data can easily cause operational complexities in any government agency. With massive data elements from different sources, it is necessary to organize and classify data so that the agency can efficiently search, use and manage data. Refer to NEA DRM. Based on the data required by the government agency, classify these data accordingly. The figure below is an example data classification. Figure ‎9-18: Example for developing data classification structure 5. Define the data structure The NEA DRM has defined data structure consisting of data elements, data entities, data properties and their relationships. Similarly, define the data structure for the agency data. The EA Core or working teams may want to start be defining the structure for commonly use data in the agency. Below is an example of data structure definitions. Note that a number of these data definitions map to the data classifications established in the above step. In addition, the agency has to docu- ment the data properties and relationships.
  • 163.
    163 National Overall ReferenceArchitecture (NORA) – Handbook Items of Entity Definition Entity Description Entity Name As entity name to be managed by agency DRM, it is uniquely, consistently named by using business terms Entity Definition Defines both what is the entity and to whom, how, where the entity is used Data Subject Area Data subject area which the relevant entity belongs to in data classification system Data Group Data group which the relevant entity belongs to in data classification sys- tem Unusual Remark of Entity Describing items to separately emphasize, except entity definition Entity Version Relevant entity’s version Entity Ownership Name or code of an agency or department creating the relevant entity Table ‎9-13: Example data structure definition 6. Define the data exchanges Finally, define the data exchanges with other government agencies. Based on the data entities defined above, simply list all the data exchanges. For alignment, please refer to the NEA DRM for the data exchange definitions and methods. The table below is an example list of data ex- change. S/ No Data Entity Agency Name / Location Exchange Description Exchange Frequency Exchange Direction 1 Name of data entity Name of agency and location or branch Description about the data exchange and data entity Frequency such as monthly, weekly, daily, hourly Inbound or Outbound Table ‎9-14: Example data exchange definition
  • 164.
    164 National Overall ReferenceArchitecture (NORA) – Handbook 7. Document and review Upon completion of the above deliverables, the EA Core and working teams have to document the DRM according to the agency’s documentation standard. Carry out an internal review. In addition, it is recommended to get other parties to review the DRM such as the business team and the DBAs. 8. Obtain governance approval With the completion of the deliverables with the other above related contents, present it to the EA Governance Committee. The Chief Architect or Data Architect should front this pre- sentation. From the comments from the committee, make the necessary changes to obtain their final approval. 9.5.5 Step 5.5 Build technology reference model The Technology Reference Model (TRM) classifies and defines technologies and technology standards/specifications that support businesses and services. The purpose of TRM is for enu- merating and understanding the underlying IT service & technology elements, analyzing them and then applying classifications and relevant standards. NEA TRM Figure 9-19 shows the NEA TRM artifacts while Table 9-15 describes the artifacts and deliver- ables. Government agencies have to refer and understand the NEA TRM artifacts and contents. Please refer to the TRM details and consult NEA office for clarification or discussion.
  • 165.
    165 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎9-19: NEA TRM artifacts S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of TRM 2 TRM Principles The architectural principles of TRM 3 Service Area The highest level technology service area 4 Service Category The technology service category within a service area 5 Service Standard The list of technology service standards Table ‎9-15: TRM artifact descriptions
  • 166.
    166 National Overall ReferenceArchitecture (NORA) – Handbook The table below describes the various service areas and service categories. Service Area Service Categories Service Access and Delivery Access Channels Delivery Channels Service Requirements Service Transport Service Platform and Infrastructure Support Platforms Delivery Servers Software Engineering Databases/Storage Hardware/Infrastructure Component Framework Security Presentation/Interface Programming Data Interchange Data Management Service Interface and Integration Integration Interoperability Interface Table ‎9-16: TRM service area and category descriptions
  • 167.
    167 National Overall ReferenceArchitecture (NORA) – Handbook Relationship between NEA TRM and Agency TRM The NEA TRM describes the reference for whole-of-government technology standards. By referencing the NEA TRM, a government agency can extract the relevant scope that is applicable within the agency. The agency TRM has to describe more detail technology standards where applicable if these are not describe in the NEA TRM. At the same time, the agency TRM has to ensure alignment with the NEA TRM in terms of the high-level service areas and service categories. Building the Agency TRM Below table summarizes the main activities for building the agency TRM. S/No Activity Artifact / Deliverable 1 Define the TRM purpose or direction TRM purpose / direction statement 2 Define the TRM principles TRM principles 3 Define the service areas and service categories Service categories within service areas for the agency 4 Set the service standards Service standards(standard profile) within each service category relevant for agency 5 Document and review Reviewed draft TRM 6 Obtain governance approval Approved agency TRM Table ‎9-17: Main activities to build agency TRM 1. Define the TRM purpose or direction Depending on the actual EA scope for the government agency, it has to define the appropri- ate TRM purpose or direction. The government agency can refer to the NEA TRM’s purpose or goals to further refine or localize its purpose. It is also necessary to refer to the agency PRM and incorporate relevant strategic goals and measurements into the TRM. Figure 9-16 below shows an example of the TRM purpose and direction.
  • 168.
    168 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎9-20: Example TRM purpose Figure ‎9-21: Example TRM structure
  • 169.
    169 National Overall ReferenceArchitecture (NORA) – Handbook 2. Define the TRM principles Refer to NEA TRM principles to adopt and adapt for the government agency’s own TRM prin- ciples. Note that good principles would aid or direct the subsequent development work of the TRM. As a guide, there should not be more than seven principles. 3. Define the service areas and service categories With reference to NEA TRM (see Table 9-17 above), analyze and localize the service areas and service categories. In most cases, the agency would adopt all the service areas, as these are high-level technology classifications. However, the agency may add or remove if required (this is possible if the gov- ernment agency’s scope for TRM or EA is limited). For each service area, analyze if the government agency requires the service categories. Simi- larly, the agency may add or remove service categories if required. As the service areas and inter-connected with the service categories, it is recommended to do a thorough review for applicability. 4. Set the service standards Setting the service standards require research and thorough analysis. The government agency can refer to NEA TRM’s service standards and adapt them for the agency. To set the service standards, the following activities are highly recommended: a. Define ‘standard’ method to define service standards Firstly, it is necessary to define carefully the standard method to set the service standards. The agency TRM’s principles may affect the service standards adoption and description. For example, if one of the TRM principles is not to use vendor-specific technology, then the service
  • 170.
    170 National Overall ReferenceArchitecture (NORA) – Handbook standard cannot describe the vendor products or technology standards. On the other hand, if there is no such principle on vendor products, the service standards can refer to both open standards and vendor-specific products. It is also necessary to define the standard classification such as: i. Mandatory – standards that shall be complied ii. Recommended – standards that are good to comply but not a must iii. New – latest technology standards that can be used if possible iv. Obsolete – standards that are outdated and should be replaced. Another consideration is to describe the status and publish date of the standards so that read- ers know if these are new, revised or outdated standards. The EA Core team should also ensure that these standard classifications are align with the com- pliance management under Continuous Governance section. It is also a ‘standard’ practice is to reference the service standards to the official organization or vendor source such as ISO, IEEE and OASIS among others. b. For each service category, collect and list all the necessary technology standards With all the technology standards, ensure that they are applicable. For related, duplicated or similar standards, the agency has to decide if would be simpler and more effective to combine the standards or separate them. After consolidating all the standards, assign the standard classification and official source of the standard.
  • 171.
    171 National Overall ReferenceArchitecture (NORA) – Handbook c. Write the actual service standards according to ‘standard’ method Finally, write the actual service standards in the format or method what was agreed. The EA Core or working team members have to consider the ability for the reader to quickly search and find the required service standards. For examples of good standards, please refer to ISO, IEC, IEEE and OASIS. 5. Document and review After drafting all the definitions and standards, document all the relevant information into a structured information base on the agency’s documentation standards. Do an internal review and updates. It is also advisable to get another party to carry out a final review. 6. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect or Technology Architect should front this pre- sentation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 172.
    172 National Overall ReferenceArchitecture (NORA) – Handbook Stage6–BuildCurrent Architecture
  • 173.
    173 National Overall ReferenceArchitecture (NORA) – Handbook 10. Stage 6 – Build Current Architecture 10.1 Stage summary Once the framework and reference models are established and agreed upon, the government agency embarks on one of the most critical steps in its EA journey. The focus of this stage is in capturing the current architectures of the government agency so that the agency can clearly understand its IT and business landscapes. This would allow a better visibility of the interconnections among different architectures and components, and aid in analyzing the agency’s issues, challenges and opportunities relating to business, information/data and technologies. The information captured and architectures created in this stage include Business Architecture, Application Architecture, Data Architecture and Technology Architecture. The government agency may build all the current architectures or selective relevant architectures depending on its EA scope and development strategy. 10.2 Stage purpose The purpose of this stage is to analyze and document the status of the current government agency’s IT and business landscapes. The expected outcomes or deliverables of this stage are: 1. Current Business Architecture 2. Current Application Architecture 3. Current Data Architecture 4. Current Technology Architecture. Note that the above are recommended outcomes. A government agency can have more or less architectures depending on its EA scope, goals, EA framework design and development strat- egy. Other examples not listed above include current security and performance architectures.
  • 174.
    174 National Overall ReferenceArchitecture (NORA) – Handbook 10.3 Stage initiation With the completion of the previous phases, the EA Core Team and working teams have to ensure that the following deliverables are in place: 1. Performance Reference Model 2. Business Reference Model 3. Application Reference Model 4. Data Reference Model 5. Technology Reference Model. Again, depending on the EA scope and development strategy, the government agency has to ensure that the corresponding reference models are completed. If the government agency intends to build all architectures, then it needs the five above reference models. However, if the government agency is doing a specific EA scope such as data and technology consolidation, then it needs to have at least the data and technology reference models in place.
  • 175.
    175 National Overall ReferenceArchitecture (NORA) – Handbook 10.4 Key steps in stage 6 Table 9-2 list the key activities and expected deliverables for stage 6. Stage / Step No Description Deliverable 6 Build Government Agency’s Current Ar- chitectures Government Agency’s Relevant Current Architectures 6.1 Capture current business and IT data Government Agency’s Current Data 6.2 Analyze and build the business architec- ture that describes the current business functions, sub-business functions, busi- ness processes, business activities and business services Government Agency’s Current Business Architecture 6.3 Analyze and build the application archi- tecture that lists all the current appli- cations (fully automated, partial auto- mated & manual), and the relationships between these applications and the business functions / processes / services Government Agency’s Current Application Architecture 6.4 Analyze and build the data architecture that shows all the current data used by the government agency, the usage of data by applications including data ex- change within and externally Government Agency’s Current Data Architecture 6.5 Analyze and build the technology archi- tecture that illustrates the current IT in- frastructure used by the various applica- tions, data and people Government Agency’s Current Technology Architecture 6.6 Current Architecture Analysis Summary of Improvement Op- portunities Table ‎10-1: Stage 6 steps
  • 176.
    176 National Overall ReferenceArchitecture (NORA) – Handbook 10.4.1 Step 6.1 Capture current business and IT data The first important step is to capture both the current business and IT data in the government agency. Current data is required to understand the actual reality of the agency’s business and IT landscapes. Data has to be up-to-date, accurate and verified. It is always better to have more detailed data than insufficient data. Depending on the agency’s actual EA scope and objectives, the EA Core and working teams have to prepare the relevant means to capture the required data. If the agency is doing the entire EA, then it has to capture information about the business, applications, data / databases and infrastructure. On the other hand, if the agency is doing only technology architecture, then it has to capture the current IT technologies and infrastructure data. However, the teams may face difficulty to obtain the support of the various parties or divisions to capture the current data. As part of change management (please see Continuous Gover- nance – Change Management section), it is recommended to provide clear communications to the relevant departments, divisions or branches in the agency on the need for EA and the data capturing exercise. The following are the recommended activities to capture current data in the agency: S/No Activity 1 Identify data elements and data sources required 2 Design data capturing method(s) 3 Design data capturing templates 4 Present to EA Governance Committee on data capturing approach 5 Brief the relevant parties 6 Capture the relevant current data 7 Verify and update Figure ‎10-1: Data capturing activities
  • 177.
    177 National Overall ReferenceArchitecture (NORA) – Handbook 1. Identify data elements and data sources required The first activity is to identify all the data elements and their respective data sources. The EA Core and working teams can first refer to their reference models to determine the minimum reference to artifacts. From these artifacts, identify the main data elements from current data- bases and application systems. The teams need also to identify data from physical sources such as forms, catalogues, websites, etc. The table below provides example sources of capturing data. Current Architecture Possible Data Sources Business Architecture 1. Organization chart 2. Agency roles and functional descriptions 3. List of business processes 4. Service catalogue (if any) Application Architecture 1. Application systems catalogue (if any); else list of all application sys- tems including application owners and application systems status 2. List of application functions Data Architecture 1. Database management system (DBMS) for all the databases 2. Database or data schema diagrams 3. List of data exchanges (external and internal) 4. Data model (if any) 5. Database catalogue (if any) 6. Data flow diagrams (if any) 7. Data dictionary (if any) Technology Architecture 1. Hardware catalogue 2. Software catalogue 3. Software license agreements 4. Network architecture diagrams 5. Data center layout diagrams 6. Storage information (including back-ups) Table ‎10-2: Example of possible data sources
  • 178.
    178 National Overall ReferenceArchitecture (NORA) – Handbook 2. Design data capturing method(s) Having identified the data elements and the data sources, the next activity is to analyze to de- termine what data is unavailable. Most of the data should be available in the current systems somewhere in the government agency. It is important to design a method(s) to capture all these data into one repository so that the data can be analyzed later in this and subsequent stages. For data unavailable or not updated, the teams may design data capturing methods such as questionnaire, data spreadsheet and even online data input screens. 3. Design data capturing templates The EA Core and working teams have to design the main templates to capture the data. Al- though different architectures require different data, the teams may consider doing an inte- grated data capturing exercise so that every data element is captured once. This is an excellent exercise for the teams to start thinking through the data required for the various architectures. The data capturing templates can be on spreadsheet or online screen. 4. Present to EA Governance Committee on data capturing approach This is one of the crucial stages in the EA journey. It is necessary and important to capture all the right amount data about the government agency. Present the data capturing approach to the EA Governance Committee so that they understand the importance. In addition, the EA Gover- nance Committee can provide appropriate directions and ensure relevant parties or divisions in the agency will support the data capturing exercise. 5. Brief relevant parties As part of change management, inform the relevant parties or divisions about the EA and in par- ticular about the data capturing exercise. This briefing aims to get the support of the relevant parties or divisions. The briefing is a good opportunity to help the spread the message about the EA benefits.
  • 179.
    179 National Overall ReferenceArchitecture (NORA) – Handbook 6. Capture the relevant current data Request for specific persons to be involved in the data capturing exercise. Brief them the details of data capturing. Provide all the relevant data capturing templates and guidance to the relevant parties or divisions. The EA Core and working teams, where required, should closely help those who are capturing the current data. 7.Verify and update Verify all the data captured. The EA Core and working teams may need time to verify and update these data if required. It is recommended that data source owners review these data captured. The data captured will be used in the next steps. 10.4.2 Step 6.2 Analyze and build current business architecture In the previous stage, the team has built or document the agency’s Business Reference Model (BRM) based on the NEA Business Reference Model. The government agency’s BRM will be use as the main document to build the current Business Architecture (BA). The current BA reflects the actual business accountabilities, roles, functions, processes and ser- vices of the government agency. The current BA is useful to understand the various inter-agen- cy relationships and the detailed internal business complexity affecting the agency’s divisions, branches and departments. Relationship between Agency BA and Agency BRM In the previous stage, the team has developed the agency BRM based on NEA TRM. Thus, now is the time to reference the agency BRM to build the BA. In essence, the BA is derive from the agency BRM. The main difference, however, is the mani- festation of the various artifacts or deliverables to reflect accurately the current state in the government agency. In short, the BA has more details to depict the actual business scenarios of the government agency. The figure below shows the difference between the BRM and BA. As more data and details are required, there will also be additional artifacts as highlighted in red.
  • 180.
    180 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-2: Difference between BRM and BA Relationships among Agency BA and other architectures Table 10-13 summarizes the agency BA relationships with other current architectures. Other Current Architectures BA Relationship AA BA drives the requirements for IT applications to improve agency per- formance, productivity and customer service DA BA requires data and information for decision making and efficient op- erations TA BA provides the requirements for organization efficiency and effectiveness through technologies such as office automation and personal digital devices. Table ‎10-3: BA relationship with other architectures
  • 181.
    181 National Overall ReferenceArchitecture (NORA) – Handbook The figure below shows the relationships among BA artifacts and the relationships with artifacts from other architectures. Figure ‎10-3: BA artifacts’ relationship diagram Description about the Agency BA On completion, the current BA will depict the current business landscape of the government agency. Since the BA is an expansion of the agency BRM, the following are the artifacts or de- liverables. Note that there are three additional artifacts or deliverables. Collectively, they will provide a comprehensive description of the current BA.
  • 182.
    182 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Artifact / Deliverable Description 1 Purpose / Direction The purpose of BA 2 BA Principles The architectural principles of BA 3 Business Areas(BRM) The main business areas for the agency 4 Lines of Business (BRM) The main LoBs(Line of Business) for the agency within the business areas 5 Business Functions (BRM) The key business function descriptions within LoBs 6 Sub-Business Functions (BRM) The sub-business function descriptions within each business function 7 Business Processes The list of business process descriptions within each sub-business function 8 Organization Chart The current organization chart for the agency 9 Service Catalogue The current list of business services Table ‎10-4: BA artifact descriptions Building the Agency BA Below table summarizes the main activities for building the agency BA. S/ No Activity Artifact / Deliverable 1 Define the BA purpose or direction BA purpose / direction statement 2 Define the BA principles BA principles 3 Document the organization information Organization chart 4 Define the business functions(BRM) Reviewed / updated business areas, LoBs, business functions and created sub-busi- ness functions 5 Define the business processes List of business processes for the agency 6 Document the service catalogue Service catalogue 7 Document and review Reviewed draft current BA 8 Obtain governance approval Approved agency current BA Table ‎10-5: Activities to build BA
  • 183.
    183 National Overall ReferenceArchitecture (NORA) – Handbook 1. Define the BA purpose or direction The TA and TRM purposes are alike. The difference is that the TA purpose can show actual out- comes directly. Review the TRM purpose, amend and define the TA purpose or direction. 2. Define BA principles The BA and BRM principles are similar. The slight difference is that the BA has to describe more organizational and services information. Hence, it is necessary to review the BRM principles and may make minor changes or additions in particular about addressing more service-orientation for the government agency. 3. Document the organization information This step is simply to document the main organizational information about the government agency. This helps in ensuring alignment with government agency’s primary purpose and ac- countability. The main information to be captured are the organization chart, and its mission and vision statements. Other information such as broad strategies and goals of the government agency are optional items. Note that if the information are already available in the BRM, then the EA Core team has to simply verify and update them. If it is not available, then the information have to be officially sourced and documented. Typically, the organizational information should be available on of- ficial websites. Figure 10-3 is an example of an organization chart, while Table 10-5 lists the main attributes of an organization.
  • 184.
    184 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-4: Organizational chart example
  • 185.
    185 National Overall ReferenceArchitecture (NORA) – Handbook Property Description Relationship with national meta model Name An organizational unit is any functional unit like Corporate/department/ section that collectively executes the business functions. It is also use to represent any external entities such as Government Agencies, Ministries, Authorities and Councils. It could also represent a collaboration of multiple Organization Units (like committees and programs) - Description The government agency’s main mission, vision or role - Type The government type such as ministry, authority, council, center, program, etc. - Hierarchy Level The different organizational levels in the government agency - Child Units A group or unit of staff reporting to a higher level supervisory unit or department - Location The actual location such as city or town names - Has Positions The number of positions in the same hierarchy - Owned Business function The business functions owned by a department or unit - Owned Business Services The business services owned by a department or unit - Table ‎10-6: The properties of organization chart 4. Define the business functions(BRM) In this step, the EA Core team and working teams have to analyze and document important architecture elements together – Business Areas, LoBs, Business functions and sub-business functions. It is highly recommended that the team member with the most experience and knowledge in the Saudi government roles, functions and processes lead this exercise. Figure 10-4 illustrates the relationships among the various elements in BA. Review the business areas in the BRM. Ensure that the current business areas identified are still relevant. The team members may want to check if there added new accountabilities or
  • 186.
    186 National Overall ReferenceArchitecture (NORA) – Handbook responsibilities for the government agency mentioned through royal decrees or government official announcements as these may affect this review process. For each business area, review all the relevant LoBs that the government agency is responsible. Refer to the government agency’s BRM. Ensure and verify that the list of LoBs in the BRM are correct. Note that nearly all government agencies would have LoBs in different business areas. It is important that the team comb all the LoBs in the NEA BRM as a verification exercise. For each LoB, the EA Core team and working teams have to document all the business functions within the respective LoBs. While the BRM may list some of these business functions, the team has to verify and add other missing business functions if any. This exercise would ensure that all the government functions are documented – both primary and secondary. As a guide to verify the business functions, the team can review the top 4 levels of the organization chart includ- ing all the divisions and departments. It is a norm to have a range between 10 and 30 business functions for a government agency. Within each business function, the team now has to analyze and list all the sub-business func- tions. These are finer grain descriptions about the business function. A business function nor- mally has 2 or more sub-business functions. The team can review the organization chart as a guide - especially at levels 5 and lower where all the units, branches and teams are define. A government agency typically has 40 to 100 sub-business functions. Document all the business functions and sub-business functions in the example format below. Figure ‎10-5: Business area, LoB, business function and sub-business function diagram example
  • 187.
    187 National Overall ReferenceArchitecture (NORA) – Handbook Property Description Relationship with national meta model Name The name of business function - Description The detail description of this function - Level The level of relevant business function such as area, LOB, function, and sub-function - Upper function The related upper function’s name. ‘Sub-function’ should be related with one of ‘function’ - Figure ‎10-6: The properties of business function description 5. Define the business processes Having documented all the business and sub-business functions, the EA Core team and working teams have to work with the business owner or representatives to analyze and to document all the business processes within each sub-business function. Note that the NEA and government agency’s BRM do not have this list of business processes. Although this is a tedious task, it is important to document all the business processes so that the government agency can visualize and identify areas of improvements to the various business functions and sub-functions. This task is also necessary to facilitate the discovery of potential processes that can be improved or re-engineered to improve the sub-business function or busi- ness function as a whole. These business process improvements aid the agency’s e-Government transformation journey. It is highly recommended that the departments or branches responsi- ble for these sub-business functions dedicate staff to work with the EA Core and working teams. For a start, the EA Core and working teams have to understand and agree on the following im- portant definitions:
  • 188.
    188 National Overall ReferenceArchitecture (NORA) – Handbook a. A sub-business function normally has two or more business processes b. A business process consists of a series of business activities carry out to perform a specific business outcome; it has one or more inputs and one or more outputs c. The business processes, if automated, are supported by one or more IT applications. Figure 10-6 shows the information about a sub-business function. Figure ‎10-7: Contents of a sub-business function Figure 10-7 shows the main information about a sub-business function using one of MOE’s examples. Note that this is for illustrative purpose only and does not contain the full updated information. In this example, the sub-business function of Licensing Management has four business processes.
  • 189.
    189 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-8: MOE’s sub-business function & business process relationship Document the sub-business function and its processes as shown in the tables below. Attribute Description Sub-Business Function ID B.1.3 Sub-Business Function Name Licensing Management Sub-Business Function Description Manage the issuance, update and revoke of private school license Input • Company Registration ID • Payment by requestor Output Private School Operating Certificate Application Systems • Licensing Portal System • Private Schools Management System • National Shared Payment System Table ‎10-7: Example of sub-business function description
  • 190.
    190 National Overall ReferenceArchitecture (NORA) – Handbook Process ID Process Name Process De- scription Process Owner Input Output B.1.3-1 Manage Licensing Rules Manage and update the various rules / conditions relating to the operating private schools Licensing Management Director Updates from ministries; royal decrees Updated set of rules B.1.3-2 Register & Maintain Private Schools List Create and Update list of private schools Licensing Management Director Updated set of rules Updated Private Schools List B.1.3-3 Process Request for new, update or terminate Review and ap- prove or reject the request for a new / update / terminate private school Licensing Management Director Request Approved request B.1.3-4 Issue or Revoke License Print and issue physi- cal license; Remove and revoke physical license Licensing Management Director Approved request New license or revoke license Table ‎10-8: Business process description example
  • 191.
    191 National Overall ReferenceArchitecture (NORA) – Handbook Document all the activities within each process. The table below is an example of the activities under ‘Process New Request for Private School’ i.e. B.1.3-3. Activity ID Activity Name Activity De- scription Activity Owner Input Output B.1.3-3-1 Validate request Check all relevant information in request Private Schools Licensing Officer Request form Nil B.1.3-3-2 Verify request Verify request is valid and correct Private Schools Licensing Officer Request form Nil B.1.3-3-3 Check for simi- lar school Ensure that the proposed school name is not in use Private Schools Licensing Officer Request form Nil B.1.3-3-4 Check owner’s records Carry out detailed financial and criminal checks on owner(s) Private Schools Licensing Officer Proposed owner’s national ID Proposed owner’s status B.1.3-3-5 Check curricu- lum compliance Check for compliance to national curriculum Curriculum Edu- cation Officer Proposed curriculum plan Curriculum compliance status B.1.3-3-6 Conduct physi- cal check Check proposed private school environment Private Schools Licensing Officer Proposed site location information Physical location status B.1.3-3-7 Decide on request Decide to approve or reject Private Schools Licensing Officer Outputs from previous activities Decision Table ‎10-9: Business activity description example In addition to the activity description above, it is highly recommended to depict the process and activities in a process map. Figure 10-8 is an example process map.
  • 192.
    192 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-9: Business process map example 6. Document the service catalogue From the list of business processes and activities, the EA Core and working teams can analyze jointly with the sub-business function owner and process owners to document the services offered to citizens (G2C), businesses (G2B), employees (G2E) and other government agencies (G2G). As part of the current business architecture, it is important to know what services (either electronic or manual) are offered within each sub-business function. This would aid the government agency to identify areas for business or service transformation. Typically, a set of business processes will form one distinct service offering by the government agency. Within a sub-business function, there can be one or more sets of related business processes, hence one or more services. It is common mistake to equate business processes to the delivery of services, i.e. it is a mistake to equate one business process = one service. Sometimes, even detailed business activities are regarded as services (for example, a business process may have 5 activities that produce so-called 5 services). Always view a service from the customer’s perspective, i.e. outcome that has a value to the customer. Business process and activities on how to carry out the service is of no concern to the customer, although it is major concern for the business or function owner.
  • 193.
    193 National Overall ReferenceArchitecture (NORA) – Handbook Analyze the business processes and document the services as follows: a. Using the business process maps, identify any service offered for each business process (i.e. output to a stakeholder or customer is usually a service) b. Document the service according to its categorization (please see Table 10-9). Ensure that the format is same or similar, as the service details are required to consolidate for the National Saudi Government Service Catalogue. Table 10-10 shows an example service catalogue c. Analyze to remove duplicate services across different business processes. Property Description Relationship with national meta model Service ID Unique service identifier Business service(SRS) Business Service Name Name of the business service Business service(SRS) Business Service Description Description of the business service Business service(SRS) Service Type Based on Consumer Category of the business service, i.e. G2C, G2B, G2G or G2E Business service(SRS) Service Type based On Granularity Main Service or Sub Service Business service(SRS) Service Maturity Maturity of Service- Informative, Transactional etc.. Business service(SRS) Service Delivery Channel Mode of the service delivery such as manual, online, kiosk or combination Business service(SRS) Service Location Location of the Service being delivered. Business service(SRS) Service Owner Name or designation of the service owner Business service(SRS) Service Fees The amount charged from consumers of the service Business service(SRS) Service Output Outputs at the end of the service such as documents, reports and updated information Business service(SRS) Pre-Requisite Mandatory requirement or condition before the service can start Business service(SRS)
  • 194.
    194 National Overall ReferenceArchitecture (NORA) – Handbook Property Description Relationship with national meta model Service Requirements Supporting documents required to use the service Business service(SRS) Business Process Af- fected Zero, one or more services affected by this business process; the affected services identified by their unique Service ID Business service(SRS) Data Dependency Data required from other agencies to execute the service Business service(SRS) Service Linkage Is this service utilized by other agencies to execute their own services Business service(SRS) Servicing Time Time required to deliver the service to consumer from service request to the logical end. Business service(SRS) Table ‎10-10: The properties of service catalogue Using the MOE’s example, there are 2 services rendered under the Licensing Management as shown in the table below. Service ID Business Service Name Business Service Description Service Category Service Owner Service Output Pre-Requisite Service Mode Business Process Affected B.1.1 Search for Private School (e.g. by school name) Allows public to search a private school in KSA. Details include the location of the school, school contact information and the basic teach- ing curriculum G2C / G2B Licensing Manage- ment Director Private School details Nil Online B.1.3.1 B.1.2 Register and Update Private School Register new private schools, update infor- mation about private schools and the removal of private schools. This service includes the issue of private school operat- ing license G2B Licensing Manage- ment Director Private School Operating License Company Regis- tration Number, Prior payment for services Online with manual checks and ap- proval B.1.3.1, B.1.3.2, B.1.3.3, B.1.3.4 Table ‎10-11: Service catalogue example
  • 195.
    195 National Overall ReferenceArchitecture (NORA) – Handbook 7. Document and review Document all the above information according to the agency’s documentation standards. Do an internal review and updates. It is also advisable to get another party (especially the business owner and business teams) to carry out a final review. 8. Obtain Governance Approval With the completion of the above deliverables, present to the EA Governance Committee. The Chief Architect or Business Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval. 10.4.3 Step 6.3 Analyze and build current application architecture Application architecture (AA) represents a focal point for a government agency’s IT applications. It defines how what applications are available, how they support the business and who the users are. Application architecture will directly help in aligning the government agency business processes to application systems that support them. The objective of current application architecture is to describe the application systems & their relationships that are currently in use by the various business functions. By understanding this current reality, it gives many opportunities to find areas for business automation, remove application duplications and improve integration for both business and application systems. Relationship between Agency AA and Agency ARM In the previous stage, the team has developed the agency ARM based on NEA ARM. Thus, now is the time to reference the agency ARM to build the AA. The agency AA shows the current reality based on the main artifacts of ARM. It describes the various artifacts or deliverables that reflect accurately the current state in the government agency in terms of application systems. In short, the AA has more details than the ARM to depict the actual application system scenarios of the government agency.
  • 196.
    196 National Overall ReferenceArchitecture (NORA) – Handbook The figure below shows the difference between the ARM and AA. As more data and details are required, there will also be additional artifacts as highlighted in red. Figure ‎10-10: Difference between ARM and AA Relationships among Agency AA and other architectures Table 10-9 summarizes the agency BA relationships with other current architectures. Other Current Architectures AA Relationship BA AA provides application systems to the various business functions in the government agency DA AA requires data model and data elements to be use for decision making and efficient operations TA AA provides the requirements for technologies to support the hosting and usage of application systems Table ‎10-12: AA relationship with other architectures
  • 197.
    197 National Overall ReferenceArchitecture (NORA) – Handbook The figure below shows the relationships among AA artifacts and the relationships with artifacts from other architectures. Figure ‎10-11: AA artifacts’ relationship diagram Description about the Agency AA On completion, the current AA will depict the current application landscape of the government agency. Since the AA is an expansion of the agency ARM, it provides a catalogue of current applications. The application catalogue and three other additional artifacts or deliverables provide a comprehensive description of the current AA.
  • 198.
    198 National Overall ReferenceArchitecture (NORA) – Handbook S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of AA 2 AA Principles The architectural principles of AA 3 Application Systems (ARM) The main application systems for the agency 4 Application Components (ARM) The key application components for the agency 5 Application Interfaces (ARM) The main application interfaces for the agency 6 Application Catalogue The list of applications and their attributes 7 Application Functions The description about the application functions 8 Application Relationships The description about the application relationships 9 Application Overview The overview description of the application systems Table ‎10-13: AA artifact descriptions Building the Agency AA Below table summarizes the main activities for building the agency AA. S/No Activity Artifact / Deliverable 1 Define the AA purpose or direction AA purpose / direction statement 2 Define the AA principles AA principles 3 Review application systems, application components and application interfaces (ARM) Reviewed / updated application systems, application components and application interfaces 4 Document the application overview Application overview 5 Document the application catalogue Application catalogue 6 Document the application functions Application functions 7 Document the application relationships Application relationships 8 Document and review Reviewed draft current AA 9 Obtain governance approval Approved agency current AA Table ‎10-14: Activities to build AA
  • 199.
    199 National Overall ReferenceArchitecture (NORA) – Handbook 1. Define the AA purpose or direction While the agency ARM provides a good reference to the logical parts of the various applications, the purpose or direction of the agency AA would describe how these application systems could actually support the business. Review the ARM purpose, amend and define the AA purpose or direction. 2. Define AA principles The AA and ARM principles are similar. The slight difference is that the AA has to describe the details of the application systems, components and interfaces. In addition, the AA principles have to address about the application development issues and processes. Hence, it is necessary to review the agency ARM principles and make minor the necessary changes or additions. 3. Review application systems, application components and application interfaces (ARM) From the ARM, review the application systems, components and interfaces. These have been define to guide the agency in the application development. Simply review all these and make the necessary additions, amendments and deletions. 4. Document the application overview The purpose of application overview is to illustrate a high-level representation of all the current applications within the agency. The application overview should include at least the following details: Attribute Description Relationship with national meta model Application Name The internal name of the application Application system(Name) Category Name A logical group of the applications. It can be based on any logical grouping such as being core business applications or supporting applications - Table ‎10-15: The properties of application overview
  • 200.
    200 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-12: Application overview example 5. Document the application catalogue From the application systems, components and interfaces reviewed, the EA Core and working teams can simply define and document all these information into a structured application cata- logue. With this application catalogue, it is easy and fast to find all the necessary information about the various current applications in the agency. The purpose of this viewpoint is to describe the contextual elements of the application such as the application modules, application services, development type, maintenance cost, etc. Ap- plication catalogue is use to identify a list of all the current applications with their details in the agency. This view should include at least the following attributes:
  • 201.
    201 National Overall ReferenceArchitecture (NORA) – Handbook Property Description Relationship with national meta model Application Name The internal name of the application Application system(Name) Application Description Some details about the application Application system(Purpose) Application Type Core business application or support - Business function List of business function supported by application - Business Owner The Business unit owning the application - Development Type Externally developed, In-house, out- sourced, commercial off the shelf, etc. Application system(Introduction method) Vendor The name of the application’s vendor - Version Application’s version - Environment Test, production, development - Number of Licenses The number of the user licenses of the application - Development language Microsoft .Net, Eclipse Java EE, Oracle Forms. etc. Application system(Development language) Related Database The name of the related database - Hosted Server Name / IP The name or IP address of the server hosted the application - Launch Date The date in which the application be- came in production - Retirement Date The date that the application has been / will be retired - Total cost The total cost of the application Application system(Total develop- ment cost) Maintenance Cost The annual maintenance cost of the application Application system(Annual main- tenance cost) Table ‎10-16: The properties of application catalogue
  • 202.
    202 National Overall ReferenceArchitecture (NORA) – Handbook Below is one example entry of an application catalogue. Application Attribute Description Application Name Training Application Descrip- tion This application is used for training registration (In-service Training and Pre Service Training) Application Type Core business application Business Service Admission and Registration for In-Service Training Admission and Registration for Preparatory Training Business Owner Admin and Registration department Development Type In-house developed Vendor Oracle Version Developer 6i Environment In production Number of Licenses N/A Development lan- guage Oracle Forms. Related Database Hopd5 Hosted Server Name/ IP Training_Srv/10.10.10.5 Launch Date 11/05/2010 Retirement Date 11/05/2016 Total cost 3.510000 SAR Maintenance Cost 860000 SAR Table ‎10-17: Application catalogue example
  • 203.
    203 National Overall ReferenceArchitecture (NORA) – Handbook 6. Document the application functions The purpose of application functions is to identify and describe the functions (activities) per- formed by the systems in order to depict the relationship between applications and business functions within the agency. This view is useful when identifying the application systems used by a particular business function. It also allows the identification of duplicated system functions among applications. Hence, it allows analysis of duplicated business functions or duplicated ap- plication systems. The application functions should include at least the following details: Property Description Relationship with national meta model Application Name The internal name of the application system Application system(Name) Module / Sub Module Name A module/sub module is a software component or part of a program and in an enterprise-level software application may contain several different modules, and each module serves unique and separate business operations - Function Descrip- tion The description of the main function of the application / module/ sub module - Table ‎10-18: The properties of application function
  • 204.
    204 National Overall ReferenceArchitecture (NORA) – Handbook The table below is an example of an application function description. S/ No Application Name Module Name Sub Module Name Function Description 1 Training Trainee system N/A Registration for Training (In-service Training and Pre Service Training) 2 Planning and Development Scholarship System  N/A Support faculty members to get higher education (Master and Ph.D.). All details of faculty member who are going for higher study, their scholarship etc. are captured in this system Planning System  N/A Plan annual activities of the organization
  • 205.
    205 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Application Name Module Name Sub Module Name Function Description 3 Business Human Resources Job Positioning Classifies the organization job titles and manages all transactions Human Resources Personnel System Manages all employee transactions (employment, promotions etc.) Human Resources Evaluation system Evaluates employee performance Human Resources Payroll system Processes all payroll and financial claims made by employees Human Resources Delegation & Banking Controlling all banking transfers Human Resources Vacations system Manage and archive all kinds of vacations (normal, emergency, sick vacation) Human Resources Housing system Managing all Campus facilities Human Resources General Query & statistics On the basis of query and data, it produces a dashboard to the decision makers Human Resources Cooperative staff Keep all information of Cooperative/Support staff Human Resources Organization Social committee Managing all financial activities of the organization social com- mittee Human Resources Residency system Following up all housing residency procedures such as renew- ing, exit & return forms Stock Control System Purchasing Controlling all goods requisitions from the organization departments, verifies the request, asking for vendors quotations, and completing purchase cycle Stock Control System Inventory Managing all inventory items stock of the organization Stock Control System Stock Control Control all purchasing and inventory procedures of IPA Stock Control System Materials Assignment Following up all IPA properties/materials which are assigned to employees or departments Stock Control System Recruiting system Recruit new employees by conducting entrance examinations for academic and non-academic jobs. Also accept all online applications submitted by candidates. Archiving System for internal Document  N/A The system is used for indexing and scanning all IPA internal documents Accounting System  N/A Government Accounting system Communication System for incom- ing letters  N/A The system is used for incoming letters from other organization., The system is used for indexing and scanning of letters/docu- ments Table ‎10-19: Application function example
  • 206.
    206 National Overall ReferenceArchitecture (NORA) – Handbook 7. Document the application relationships The purpose of application relationship is to define relationships among different applications (internal or external) in order to understand the degree of interaction and the data exchange among these applications. This view should include the details in the table below. Property Description Relationship with national meta model Application Name The internal name of the application Application system(Name) Interacting Application The name of the interacted application with the first application Integration Objective The purpose of the integration Interface Name / Type The details of the Integration Interface between the two applications Data Entity The name of the data entity exchanged between the applications Data(Name) Flow Direction of the relationship (unidirectional or bidirec- tional) Frequency The frequency of exchanging data through the interface Connectivity Type The type of network connectivity between the two applications: Internet, LAN, Offline, etc. Table ‎10-20: The properties of application relationship Below is an example of application relationship description of the current internal application integration details.
  • 207.
    207 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Application Name Interacting Application Integration Objective Interface Name / Type Data Entity Flow Frequency Connectivity Type Business All Applica- tion Employee info N/A Em- ployee Data Out Daily LAN Training Business To transfer money to student N/A Student Data Out Daily LAN Training Planning and Development Info about training like how many training conducted, seminars, etc. N/A N/A Out Daily LAN Consultation Planning And Development Info about consultation and statistics N/A N/A Out Daily LAN Table ‎10-21: Application relationship example 8. Document and review With the completion of the various application documentation, consolidate them into one structured document according to the agency documentation standards. Carry out an internal review to verify all the data and artifacts. It is also recommended that an external or third party (for example application owners) carry out another review. Based on their feedback, make the necessary improvements. 9. Obtain governance approval With the completion of the deliverables with the other above related contents, present it to the EA Governance Committee. The Chief Architect or Application Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 208.
    208 National Overall ReferenceArchitecture (NORA) – Handbook 10.4.4 Step 6.4 Analyze and build current data architecture The objective of the current data architecture (DA) is to describe the data entities and structures used by the business services and business applications. The data architecture describes how data is processed, stored, and utilized in the government agency. The data architecture is a crucial component in establishing an overall adaptive environment that enhances and facilitates data sharing across the agency. Relationship between Agency DA and Agency DRM In the previous stage, the team has developed the agency DRM based on NEA DRM. Thus, now is the time to reference the agency DRM to build the DA. The DA represents the elements associated with the information in the government agency such as conceptual data model, logical data model, data entities, databases and other data-related elements. The agency DA shows the current reality based on the main artifacts of the agency DRM. It describes the various artifacts or deliverables that reflect accurately the current state in the government agency in the use of data. In short, the DA has more details than the DRM to depict the actual data scenarios of the government agency. The figure below shows the difference between the DRM and DA. As more details are required, there will also be additional artifacts as highlighted in red.
  • 209.
    209 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-13: Difference between DRM and DA Relationships among Agency DA and other architectures Below table summarizes the agency DA relationships with other current architectures. Other Current Architectures DA Relationship BA DA provides information on agency-wide data and sources of data from external parties; this aids decisions on data sharing and re-use AA DA provides data models, database information and data elements to be use by application systems TA DA provides the requirements for technologies to support the hosting and usage of database systems and data exchanges Table ‎10-22: DA relationship with other architectures
  • 210.
    210 National Overall ReferenceArchitecture (NORA) – Handbook The figure below shows the relationships among DA artifacts and the relationships with arti- facts from other architectures. Figure ‎10-14: DA artifacts’ relationship diagram Description about the Agency DA On completion, the current DA will depict the current data landscape of the government agen- cy. Since the DA is an expansion of the agency DRM, it provides a catalogue of data and the data models currently in use. There will be five additional artifacts in the DA. Together, they give a comprehensive description of the current data usage in the government agency.
  • 211.
    211 National Overall ReferenceArchitecture (NORA) – Handbook S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of DA 2 DA Principles The architectural principles of DA 3 Data Model (DRM) The main data model for the agency 4 Data Classifications (DRM) The key data classifications 5 Data Structure (DRM) The main data structures for the agency 6 Data Exchange (DRM) The list of data exchanges for the agency 7 Conceptual Data Model The pictorial high-level description of data model for the agency 8 Logical Data Model The logical data models of the agency 9 Data Flow Diagrams The various pictorial representations of data flows for the agency 10 Database Portfolio Catalogue The consolidation of all databases in the agency 11 Data Dictionary The definitions for common data in the agency Table ‎10-23: DA artifact descriptions Building the Agency DA Table 10-24 summarizes the main activities for building the agency DA. S/ No Activity Artifact / Deliverable 1 Define the DA purpose or direction DA purpose / direction statement 2 Define the DA principles DA principles 3 Review data model, data classifications and data structures (DRM) Reviewed / updated data model, data classifications and data structures 4 Create the conceptual data model Conceptual data model 5 Create the logical data model Logical data model 6 Document the data flow diagrams Data flow diagrams 7 Compile the database portfolio catalogue Database portfolio catalogue 8 Document the data dictionary Data dictionary 9 Document and review Reviewed draft current DA 10 Obtain governance approval Approved agency current DA Table ‎10-24: Activities to build DA
  • 212.
    212 National Overall ReferenceArchitecture (NORA) – Handbook 1. Define the DA purpose or direction While the agency DRM provides a good reference to the high-level data model, data classifications and structures, the purpose or direction of the agency DA is to describe the actual data usage landscape. Review the DRM purpose, amend and define the DA purpose or direction. 2. Define DA principles The DA and DRM principles are similar. The slight difference is that the DA has to provide more information about the actual data landscape in the government agency. Hence, review the DRM principles and amend them to catalyze the development of agency-wide data landscape. 3. Review data model, data classifications and data structures (DRM) From the DRM, the EA Core and working teams have to review the data model, data classifications and data structures. Add, amend or delete the information if required. This information will be required for the next few activities. 4. Create the conceptual data model A conceptual data model identifies the highest-level relationships between the different data entities using ERD notation with at least the following details: Property Description Relationship with national meta model Data Entity The name of the data entity exchanged be- tween the applications Data(Name) Entity Relationship The relationship between data entities and the multiplicity - Table ‎10-25: The properties of conceptual data model
  • 213.
    213 National Overall ReferenceArchitecture (NORA) – Handbook Below is an example of a conceptual data model. Figure ‎10-15: Conceptual data model example 5. Create the logical data model A logical data model describes the data in more detail, without regard as to how they will be physical implemented in the database. Features of a logical data model include: Property Description Relationship with national meta model Data Entity The name of the data entity Data(Name) Entity Relationship The relationship between data entities - Attributes All the attributes of the entity - Primary Keys A list of the primary key(s) - Foreign Keys A list of the foreign key(s) - Table ‎10-26: The properties of logical data model
  • 214.
    214 National Overall ReferenceArchitecture (NORA) – Handbook The figure below is an example of a logical data model. Draw the logical data model for the agency. Figure ‎10-16: Logical data model example 6. Document the data flow diagrams Data flow diagram represents both input and output information from the application systems. It also shows the data storage locations, data sources and data destinations. Through pictorial diagrams, it is efficient and easy to gather information on data supplier and consumer, including the transformation points of the data. From the logical data model, analyze the inputs and outputs to each data entity. Map the data stores, inputs and outputs into the business processes developed in BA. The table below is example of attribute descriptions, while the figure is an example data flow diagram. Finally, draw all the relevant data flow diagrams.
  • 215.
    215 National Overall ReferenceArchitecture (NORA) – Handbook Property Description External Entity (Input / Output) An external entity can represent a human, system or subsystem. It is the data source or destination. Process (Function) A process is a business activity or function where the manipula- tion and transformation of data takes place. Data Store A data store represents the storage of persistent data required and/or produced by the process. Data entity and database table are the examples of data stores. Data Flow A data flow represents the flow of information, with its direction rep- resented by an arrowhead that shows at the end(s) of flow connector. Table ‎10-27: The properties of data flow diagram Figure ‎10-17: Data flow diagram example
  • 216.
    216 National Overall ReferenceArchitecture (NORA) – Handbook Compile the database portfolio catalogue The purpose of database portfolio catalog is to identify the databases use by application sys- tems (listed in current AA). This artifact also provides the logical mapping between related data elements that is very useful in depicting the holistic view of the enterprise architecture. The database catalogue should include at least the following details: Property Description Relationship with national meta model Database Name of database use by application systems - Description High level database description - DBMS Information Some details regarding the database management system (Oracle DB, Adabas, DB2, MySQL, etc.) - Server Name / IP The name or the IP address of the database server - Database Size The size of the database - Backup Info Frequency of the backup and data backup recovery plan - Business Criticality Business criticality of the database (e.g. very critical, normal, low) - Business Owner / Unit The data owner - Table ‎10-28: The properties of database portfolio catalogue For each of the logical data model, identify the corresponding database(s). Document all the details in the database portfolio catalogue as shown in the example below.
  • 217.
    217 National Overall ReferenceArchitecture (NORA) – Handbook The table below provides a general example of the database details view. S/No Database Name Description DBMS Info Server Name/IP Database Size Backup Info Business Criticality Business Owner / Org Unit 1 Special Training DB This database is central repository for all data related elements of special training Oracle 10gR2, 9i in J and D 172.20.1.36 10 GB Weekly backup (Cold Backup) and there is no recovery plan exists Critical Special Train- ing Dept. 2 English Training DB This database is central repository for all data related elements of English training Oracle 10gR2, 9i in J and D 172.24.8.14 2 GB Weekly backup (Cold Backup) and there is no recovery plan exists Critical English Learning Centre 3 Library DB This database is central repository for all data related elements of the library. Oracle 10gR2, 9i in J and D 172.20.1.36 10 GB N/A Average Library Dept. Table ‎10-29: Database catalogue example 8. Document the data dictionary The purpose of the data dictionary is to define the data attributes regardless of the physical storage or form. As data dictionary defines all the common data elements, it is useful in confirming data requirements for business and other data exchanges. The data dictionary provides a comprehensive description of each data element as shown below.
  • 218.
    218 National Overall ReferenceArchitecture (NORA) – Handbook Property Description Relationship with national meta model Data Entity The name of each entity (also called a table) Data(name) Description A description of the data entity Data(description) Attribute name The name of each attribute name - Attribute description A description of the data attribute - Primary / Foreign Key Identification of primary and foreign key of each attribute - Data Type The data type of each field (text, image, date , etc.) - Field Size The maximum length of the field - Mandatory Whether this attribute is mandatory or not(Yes/no) - Table ‎10-30: The properties of data dictionary From both the logical data model and database portfolio catalogue, the team has to analyze and list all the data elements. Describe the data elements as shown in the table below.
  • 219.
    219 National Overall ReferenceArchitecture (NORA) – Handbook Property Description Data Entity Product Description An item in the catalogue of products that are available for purchase by a customer Property Description Attribute name Product Number Attribute description The unique identifier of the item in the catalogue Primary / Foreign Key Primary Key Data Type Integer Field Size 00000000 to 99999999, always 8 digits including leading zeroes Mandatory Yes Attribute name Description Attribute description Short description of the product for customer consumption Primary / Foreign Key No Data Type Character Field Size min:1, max:256 Mandatory No Attribute name Unit Cost Attribute description The current list price of the product Primary / Foreign Key No Data Type Currency Field Size SAR max 100,000,000,000 Mandatory Yes Table ‎10-31: Data dictionary example
  • 220.
    220 National Overall ReferenceArchitecture (NORA) – Handbook 9. Document and review Upon completion of the above deliverables, document all the relevant information into a structured DA document base on the government agency’s documentation standards. Carry out an internal review and appropriate updates. It is also a good practice to get an external party to review the DA document such as DBAs and business owners. 10. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect or Data Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval. 10.4.5 Step 6.5 Analyze and build current technology architecture The technology architecture (TA) describes the software and hardware capabilities that are required to support deployment of business, data, and application services. This includes ICT infrastructure, middleware, networks, and communications among others. The main objective of the current TA is to map a set of technology components - which represent software and hardware components – into a structured pictorial and descriptive view of the technologies in use by the government agency. The TA provides the detailed description of the technology-related elements and this section addresses the technology domain in the Enterprise Architecture, their purpose template, example and linkages. Relationship between Agency TA and Agency TRM In the previous stage, the team has developed the agency TRM based on NEA TRM. Thus, now .is the time to reference the agency TRM to build the TA In essence, the TA is derive from the TRM. However, the main difference is the application of the various artifacts or deliverables to reflect accurately the current state in the government agency. In other words, the TA has more details to depict the actual physical technology scenarios of the government agency.
  • 221.
    221 National Overall ReferenceArchitecture (NORA) – Handbook The figure below shows the difference between the TRM and TA. As more data and details are required, there will also be additional artifacts as highlighted in red. Figure ‎10-18: Difference between TRM and TA Relationships among Agency TA and other architectures As the EA Core and working teams have already developed other current architectures, it is important to understand their inter-relationships as summarized in below table. Other Current Architectures TA Relationship BA TA provides the client and office technologies such as PCs, mobile devices, printers and scanners to the agency employees in different branches and divisions AA TA provides the infrastructure technologies to host and support ap- plication systems and components DA TA provides the infrastructure technologies to enable data transac- tions and exchanges Table ‎10-32: TA relationship with other architectures
  • 222.
    222 National Overall ReferenceArchitecture (NORA) – Handbook The figure below shows the relationships among TA artifacts and the relationships with artifacts from other architectures. Figure ‎10-19: Relationship TA artifacts Description about the Agency TA On completion, the current TA will depict the current technology landscape of the government agency. Since the TA is an expansion of the agency TRM, the following are the artifacts or deliverables. Note that there are four additional artifacts or deliverables. Collectively, they will provide a comprehensive description of the current TA.
  • 223.
    223 National Overall ReferenceArchitecture (NORA) – Handbook S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of TA 2 TRM Principles The architectural principles of TA 3 Service Area (TRM) The highest level technology service area 4 Service Category (TRM) The technology service category within a service area 5 Service Standard (TRM) The list of technology service standards in use 6 Infrastructure Overview The high-level representation of IT landscape in the government agency (normally in diagrammatic form) 7 Infrastructure Description The descriptions of the main infrastructure technologies in use 8 Hardware Catalogue The current list of hardware 9 Software Catalogue The current list of software Table ‎10-33: TA artifact descriptions Building the Agency TA Below table summarizes the main activities for building the agency TA. S/No Activity Artifact / Deliverable 1 Define the TA purpose or direction TA purpose / direction statement 2 Define the TA principles TA principles 3 Review the service areas and service categories (TRM) Reviewed service categories within service areas for the agency 4 Review the service standards (TRM) Reviewed service standards within each service category relevant for agency 5 Analyze the data collected Nil 6 Describe the infrastructure overview High-level representation of IT landscape in agency 7 Provide the infrastructure descriptions List of infrastructure technology descriptions in use 8 Develop the hardware catalogue List of hardware in use 9 Develop the software catalogue List of software in use 10 Document and review Reviewed draft current TA 11 Obtain governance approval Approved agency current TA Table ‎10-34: Activities to build TA
  • 224.
    224 National Overall ReferenceArchitecture (NORA) – Handbook 1. Define the TA purpose or direction The TA and TRM purposes are alike. The difference is that the TA purpose can show actual outcomes directly. Review the TRM purpose, amend and define the TA purpose or direction. 2. Define TA principles The TA and TRM principles are similar. The difference lie mainly in the operational implementation of technologies such as performance, sharing of physical assets and security controls. Review the TRM principles, amend and define the TA principles. 3. Review the service areas and service categories (TRM) Review the service areas and categories to ensure that these are correct and relevant. 4. Review the service standards (TRM) Review the service standards defined in TRM. If the TRM was developed long time back (for example more than three years ago), there may be a need to even review the service categories. Review all the service standards and make the necessary updates. 5.Analyze the data collected The data collected should minimally be grouped to the appropriate service standards such as web browsers (Internet Explorer, Google Chrome), platform dependent (Windows), platform independent (J2EE, Linux), application servers, portal servers, databases (DB2, Oracle, MySQL), Storage (NAS, SAN, Cloud), LAN and WAN. Analyze the data to understand the trends or patterns in technology usage. 6. Describe the infrastructure overview The purpose of this overview is to provide a high-level representation of the IT infrastructure in the government agency and to develop a comprehensive view of the current infrastructure components such as the headquarter network and the connected branches, the internet connectivity, servers farm , LAN, WLAN, communications links, etc. The data collected and analyzed should be summarized into this infrastructure overview.
  • 225.
    225 National Overall ReferenceArchitecture (NORA) – Handbook Provide a pictorial infrastructure overview highlighting the technology components in various service standards. A example artifact is shown in the figure below. Figure ‎10-20: Infrastructure overview example
  • 226.
    226 National Overall ReferenceArchitecture (NORA) – Handbook 7. Provide infrastructure descriptions The purpose of IT infrastructure descriptions is to provide all the details needed to describe the current infrastructure components or service standards such as LAN, WAN, Internet, storage and servers. This view should include at least the following details listed in the table below. Property Supporting Document WAN WAN logical diagram The description about the WAN connectivity at the organization should include but not limited to the followings: Number of WAN links , speed of the links ,WAN technology (VPN-MPLS...), name of the internet service provider (ISP), details of WAN link redundancy ,connected branches details, GSN connection, Firewall setup details, etc. LAN LAN logical diagram The description about the LAN inside the organization should include but not limited to the followings: Number of current users (PCs), LAN Speed , service available for each user, VLANs, IP addressing scheme, links type, access switches details, and etc. Internet Internet connectivity diagram The description about the internet connectivity should include but not limited to the followings: Internet service provider (ISP) details, link speed and utilizations, load balancer details and etc. WLAN Wireless connection diagram inside the agency The description about the wireless connection should include but not limited to the followings: Wireless access setup, wireless access points details, encryption details , etc. Storage Storage solutions diagram The description about the storage details should include but not limited to the followings: Storage infrastructure details, backup descriptions, storage capacity , utilization, and etc. Server Server farm diagram The description about the server farm details should include but not limited to the followings: Number of servers used, connections details, and etc. Table ‎10-35: The properties of infrastructure descriptions
  • 227.
    227 National Overall ReferenceArchitecture (NORA) – Handbook WAN Figure ‎10-21: WAN diagram example Description The organization has only one branch connecting to the headquarter through (IP/VPN) of STC. Branch office of Jeddah is accessing Riyadh head office network and system through this VPN connection (30 Mbps) using Cisco 1800 integrated services routers installed at both ends without redundancy. This router connect to a firewall (Juniper / SSG550) to protect the organization’ network .The connection to Yessers’ GSN is through a dedicated router provided and managed by Yesser and is protected by firewalls on both ends.
  • 228.
    228 National Overall ReferenceArchitecture (NORA) – Handbook LAN Figure ‎10-22: LAN diagram example Description Riyadh head office has client server architecture and there are 1424 users (PCs) to access the infrastructure facility Cisco 3750G PoE stack switches acting as floor access switches to provide connectivity to the users and nodes. All access switches via UTP cable are aggregated to the distribution switch (Cisco 4507) at each building that have 10 Gbps uplink to the Core switch (Cisco 6509) at the data center . The IP schemas used at the organizations for the servers : 172.16.0.0/16, and for the clients: 172.18.0.0/16.
  • 229.
    229 National Overall ReferenceArchitecture (NORA) – Handbook Internet Figure ‎10-23: Internet diagram example Description The Internet connectivity is provided by two service providers (STC and Mobily) through two 20 Mpbs links. Access to the Internet from the organization takes place through a Microsoft Websense Proxy Server and Web Filter that connects to dual F5 Load Balancers which provide safe and continues internet browsing capabilities.
  • 230.
    230 National Overall ReferenceArchitecture (NORA) – Handbook WLAN Figure ‎10-24: WLAN diagram example Description The current wireless access setup is comprised of a master controller (Aruba 3600) and 73 wireless access points distributed throughout the organization. Data transmission in the wireless network is secured using WPA2 AES encryption. The Clearpass 500H is currently being configured to integrate with the Active Directory for access permissions.
  • 231.
    231 National Overall ReferenceArchitecture (NORA) – Handbook Storage Figure ‎10-25: Storage diagram example Descrip- tion Following are the details of the organization storage: • Two EMC SAN Storage: EMC VNX5300 with maximum capacity of 360TB and the utilization is 23%. • Two MDS Switch: Cisco MDS 9124 multilayer fabric switch with high availability. As a backup solution, the agency is currently using the Snap Vault solution from Net App to perform Disk-to-Disk backups (D2D) every day. Jeddah branch currently used as disaster recovery site (DR).
  • 232.
    232 National Overall ReferenceArchitecture (NORA) – Handbook Server Farms Figure ‎10-26: Server farm diagram example Description The server farm typically hosts the most important IT assets in the organization; it is connected directly to the core switch cisco 4500 .The current technology infrastructure at the organization utilizes a total of 73 physical servers (62 in the primary datacenter in Riyadh, and 11 in the DR datacenter in Jeddah . All servers come with multiple 1GB Ethernet cards, and some servers have converged network adapters (CNA) allowing them to connect to the SAN. Also the organization is deploying a VMware virtualization solution. The current virtualization includes 16 SUN/Intel-based servers with 2 CPU/16GB or 2CPU/32B specs. The virtualized en- vironment currently runs more than 23 different applications. The utilization for all the servers (virtual and physical) are not exceed 50%. 8. Develop the hardware catalogue The purpose of the hardware catalogue is to provide a list of hardware components in use across the agency including servers, switches, storages, routers, firewalls, load balancers, wireless access point, IPS, IDS, etc. Based on the data collected, develop the hardware catalogue with the following minimum details as shown in the example below.
  • 233.
    233 National Overall ReferenceArchitecture (NORA) – Handbook Property Description Relationship with national meta model Hardware Name The internal name of this component Hardware (Name) Hardware Type The type of the hardware (server , switch , router , storage, firewall, controller , wireless access point ,load balancer, etc.) Hardware (Type) Model Number The manufacturers model such as cisco 2960x, HP Proliant 460C, NetApp FAS2050, f5 3600 etc. Hardware (Model Name) Description Detail description for this component (purpose, functions, ) - Vendor The manufacturer of the device Hardware (Vendor) Application Name Business application hosted or supported by this device Application system (Name) Location The location details of this device OS Name The name of the operation system running Hardware(OS name) IP address The IP address of this device - Processors details Some details of the device processors (number and speed) - Capacity details The maximum capacity this device can accommodate. - Usage details The current usage details of this device - Connectivity details Some details about the device connectivity to the network - Introduction date The started date in which this device is used Hardware (Introduction year) Retirement Date The date that the device will be retired - Business severity The severity of business impact such as mission critical, critical, medium, and low Hardware (Business severity) Total cost Total cost of the hardware installation Hardware(Total cost) Maintenance Cost The annual maintenance cost of the hardware if applicable Hardware (Annual main- tenance cost) Table ‎10-36: The properties of hardware catalogue
  • 234.
    234 National Overall ReferenceArchitecture (NORA) – Handbook Hardware Description Hardware Name Training Server Hardware Type Server Model Number Blade HP Proliant 460C Gen8 Description This server host one of the core applications called the training system. Vendor HP Application Name Training Location DC in Riyadh (Basement floor- Cabinet#1) OS Name Windows 2000 Advanced Server -SP4 IP address 172.16.16.99 Processors details 2 processors (8 core, 2 GHz, 20MB, 95W) Capacity details 2 x 300 GB (RAID1) Usage details 19% of the max capacity used. Connectivity details 1 GB NIC connected to the core switch cisco 4500 Introduction date 10/2013 Retirement Date N/A Business severity Low Total cost 18500 SAR Maintenance Cost N/A Table ‎10-37: Hardware catalogue example
  • 235.
    235 National Overall ReferenceArchitecture (NORA) – Handbook 9. Develop the software catalogue The purpose of the software catalogue is to provide a list of software components in use across the agency such as OS, productivity tools, middleware, security tools and network management tools (NMS). Based on the data collected, develop the software catalogue with the following minimum de- tails as shown in the example below (which is for only one component). Property Description Relationship with national meta model Product/Software Name Name of software named by its manufacturer Software (Name) Software Type The type of the software (OS, security tool, middle- ware, NMS, mail, DBMS, productivity tool, etc.) Software (Type) Model / Version Software version/model Software (Name of SW) Description Some description about this component purpose, function…) - Vendor Name of software manufacturer Software (Vendor) License details Software’s license management policy (users, PCs, servers, etc.) Software (License Policy) Business Unit Business units supported by this software - Hosting Hardware Name/IP The name of the hosted server - Number of current users Number of current users using this software - Introduction date the year when the software is installed Software (Introduction year) Total cost Total cost of the software installation Software (Total cost) Annuala Maintenance Cost The cost of SW annual maintenance cost Software (Annual maintenance cost) Table ‎10-38: The properties of software catalogue
  • 236.
    236 National Overall ReferenceArchitecture (NORA) – Handbook Product/Software Name Description Software Type Network Monitoring Software Model / Version PRTG - Version 15.4.21 Description PRTG Network Monitor runs on a windows machine within the network, collecting various statistics from the machines, software, and devices in order to generate performance reports Vendor Paessler AG License details The licensing are based on the number of sensors (unlimited) Business Unit IT Department Hosting Hardware Name/IP NMS-Srv / 172.16.16.71 Number of current users N/A Started date 9/2015 Total cost 89,000 SAR /year including the maintenance cost Annual Maintenance Cost N/A Table ‎10-39: Software catalogue example 10. Document and review After drafting all the definitions and standards, document all the relevant information into a structured information base on the agency’s documentation standards. Do an internal review and updates. It is also advisable to get another party (especially the technology and operations teams) to carry out a final review. 11. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect or Technology Architect should front this pre- sentation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 237.
    237 National Overall ReferenceArchitecture (NORA) – Handbook 10.4.6 Step 6.6 Current architecture analysis It is a major accomplishment milestone on the completion of capturing the current architectures. With the information and pictorial representations, the EA Core and working teams can have different perspectives about the government agency on the business, applications, data and infrastructure. These current architectures also allow the discovery of not so obvious linkages, dependencies, and even synergies or integrated components. On the other hand is a milestone unlike any, this is because it performs many important aspects including but not limited to the following. The advantage of viewing the whole of enterprise cutting across silos, establishing the obvious and not so obvious linkages and dependencies, capturing of synergies etc. facilitate identification of opportunities for progress of the agency as well as the issues that are hindering its future growth. The current architecture analysis is an activity to understand current issues and challenges of the government agency on one hand, and to explore ideas for improvement and integration on the other hand. The following describes important activities for this step. S/ No Activity Artifact / Deliverable 1 Analyze BA BA improvement opportunities 2 Analyze AA AA improvement opportunities 3 Analyze DA DA improvement opportunities 4 Analyze TA TA improvement opportunities 5 Document and review Reviewed draft summary of improvement opportunities 6 Obtain governance approval Approved agency summary of improvements Table ‎10-40: Activities to analyze current architectures
  • 238.
    238 National Overall ReferenceArchitecture (NORA) – Handbook 1.Analyze BA Review the current BA. A recommended method is to compare the BA artifacts against the agency’s mission and vision statements, strategic goals / objectives, the agency annual plans, the Saudi e-Government Plan, the agency PRM and the agency e-transformation plan (if any). The EA Core and working teams can also use analysis tools such as Value Chain analysis, 7S analysis, SWOT analysis and business process simulation. Carry out the following activities: a. List the main issues and challenges faced in BA b. Analyze the business functions and services by logical and physical dimensions c. List the prioritized strategic business outcomes d. List the key business work activities or functions, and how they have to improve based on (a) and (c) e. Using the BA principles as a guide, define specific improvement opportunities for the list in (d). Figure ‎10-27: Example BA analysis
  • 239.
    239 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-28: Example BA improvement opportunities 2.Analyze AA Review the current AA. A recommended method is to compare the AA artifacts against the strategic goals / objectives, the agency annual plans, the Saudi e-Government Plan, the agency PRM, prioritized application list (from agency ARM) and the agency e-transformation plan (if any). The EA Core and working teams can also use SWOT analysis. Carry out the following activities: a. List the main issues and challenges faced in AA b. Identify some of the global trends in application systems c. Analyze the application systems by categories and departments / branches; also analyze the required application systems to support the BA improvement opportunities d. List the prioritized application systems, components and interfaces for development, replacement, amendment and retirement e. Using the AA principles as a guide, define specific improvement opportunities for the list in (d).
  • 240.
    240 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-29: Example AA analysis Figure ‎10-30: Example AA improvement opportunities
  • 241.
    241 National Overall ReferenceArchitecture (NORA) – Handbook 3.Analyze DA Review the current DA. A recommended method is to compare the DA artifacts against the agency annual plans, the Saudi e-Government Plan, the agency PRM and the agency e-transformation plan (if any). The EA Core and working teams can also use analysis tools such as data dependency and SWOT analysis. Carry out the following activities: a. List the main issues and challenges faced in DA b. Identify some of the global trends in data management and data usage c. Analyze the data represented by logical and physical dimensions; also analyze the required data to support the AA improvement opportunities d. List the prioritized strategic data models, data elements and databases e. Using the DA principles as a guide, define specific improvement opportunities for the list in (d). Figure ‎10-31: Example DA analysis
  • 242.
    242 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-32: Example DA improvement opportunities 4.Analyze TA Review the current TA. A recommended method is to compare the TA artifacts against the agency annual plans, the Saudi e-Government Plan, the agency PRM and the agency e-transformation plan (if any). The EA Core and working teams can also use analysis tools such as data dependency and SWOT analysis. Carry out the following activities: a. List the main issues and challenges faced in DA b. Identify some of the global technology trends and technology standards c. Analyze the infrastructure and other technologies; also analyze the required technologies required to support the BA, AA and DA improvement opportunities d. List the prioritized strategic technologies for development; also include technologies that require to be replaced or retired e. Using the TA principles as a guide, define specific improvement opportunities for the list in (d).
  • 243.
    243 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎10-33: Example TA analysis Figure ‎10-34: Example TA improvement opportunities
  • 244.
    244 National Overall ReferenceArchitecture (NORA) – Handbook 5. Document and review After completing all the analysis, consolidate all the improvement areas and document them into a structured information base on the agency’s documentation standards. Perform a cross- domain analysis (BA, AA, DA, TA), to identify and document more opportunities for improve- ment. Do an internal review and updates. It is also advisable to get other parties – business owners, application developers, DBAs and data owners, and the infrastructure team - to carry out a final review. 6. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect should front this presentation. From the com- ments from the committee, make the necessary changes to obtain their final approval.
  • 245.
    245 National Overall ReferenceArchitecture (NORA) – Handbook Stage7–BuildTarget Architecture
  • 246.
    246 National Overall ReferenceArchitecture (NORA) – Handbook 11. Stage 7 – Build Target Architecture 11.1 Stage summary With the completion of the government agency’s current architectures, this stage develops the target architectures. As a blueprint for the government agency to realize its goals and desired out- comes in 3 to 5 years, the target architecture defines the improved business and IT landscapes. The detailed analysis will lead to the development of target architectures that include Business Architecture, Application Architecture, Data Architecture and Technology Architecture. The government agency may build all the target architectures or selective relevant architectures depending on its EA scope and development strategy. 11.2 Stage purpose The purpose of this stage is to analyze, design and document the target government agency’s IT and business landscapes. The expected outcomes or deliverables of this stage are: 1. Target Business Architecture 2. Target Application Architecture 3. Target Data Architecture 4. Target Technology Architecture. Note that the above are recommended outcomes. A government agency can have more or less architectures depending on its EA scope, goals, EA framework design and development strategy. Other examples not listed above include target security and performance architectures.
  • 247.
    247 National Overall ReferenceArchitecture (NORA) – Handbook 11.3 Stage initiation With the completion of the previous stages, the EA Core Team and working teams have to en- sure that the following deliverables are in place: 1. Summary of Improvement Opportunities 2. Current Business Architecture 3. Current Application Architecture 4. Current Data Architecture 5. Current Technology Architecture. As mentioned above, depending on the EA scope and development strategy, the government agency has to ensure that the corresponding current architectures are completed. If the government agency intends to build all architectures, then it needs the five above current architectures. However, if the government agency is doing a specific EA scope such as data and technology consolidation, then it needs to have at least the data and technology architectures in place. 11.4 Key steps in stage 7 Below table list the key activities and expected deliverables for stage 7.
  • 248.
    248 National Overall ReferenceArchitecture (NORA) – Handbook Stage / Step No Description Deliverable 7 Build Government Agency’s Target Architectures 7.1 Define directions for developing target architecture by analyzing environmental factors such as agency’s vision/principles, current architectures etc. Target Architecture direction 7.2 Analyze and build the target business architecture based on architecture principles, current business ar- chitecture’s analysis result, and current business ar- chitecture deliverables. Government Agency’s target Business Architecture 7.3 Analyze and build the target application architecture based on architecture principles, current application architecture’s analysis result, and current application architecture deliverables. Government Agency’s target Application Architecture 7.4 Analyze and build the target data architecture based on architecture principles, current data architecture’s analysis result, and current data architecture deliver- ables. Government Agency’s target Data Architecture 7.5 Analyze and build the target technology architecture based on architecture principles, current technology architecture’s analysis result, and current technology architecture deliverables. Government Agency’s target Technology Architecture Table ‎11-1: Stage 7 steps 11.4.1 Step 7.1 Define directions for developing target architecture In the previous stage, the team has built or documented the current architecture and analyzed current architecture issues. One of the outputs from the previous stage is the Summary of Improvement Opportunities. The EA Core and working teams have also previously analyzed agency’s vision/purposes & other environmental factors, and then, based on them, we can define target architecture’s directions. The table below lists the activities in defining directions for target architecture.
  • 249.
    249 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Activity Artifact / Deliverable 1 Review agency EA vision and principles Reviewed agency EA vision and principles 2 Review environment and requirements analysis Nil 3 Review current improvement opportunities Nil 4 Summarize target architecture directions Target architecture directions 5 Document and review Reviewed draft target architecture directions 6 Obtain governance approval Approved target architecture directions Table ‎11-2: Activities for defining target architecture directions 1. Review agency EA vision and principles Review the EA vision that agency desires to reach and review principles to build an architecture on, and get some implications to develop agency’s target architecture. Figure ‎11-1: Example of EA principles review and its implications
  • 250.
    250 National Overall ReferenceArchitecture (NORA) – Handbook 2. Review environment and requirements analysis Review the environment and EA requirements analysis done in the early stages. These would provide the overall scope and priority areas in the EA development. Analyze and gauge the need for adjustments or changes. Thus, this will ensure that architecture directions would be aligned with the overall agency EA purpose. 3. Review current improvement opportunities From the detailed review of opportunities done in the previous stage, identify improvement opportunities in each architecture area (business, application, data, technology). It would be good to consider the implications of these improvements to the government agency. The EA Core and working teams should review other strategies such as KSA 2030 Vision and the Saudi e-Government Action Plan. It is also important to review the agency PRM to help in setting performance measurements. Combine all these inputs to develop all the potential opportunities. Prioritize these opportunities based on the above reviewed principles and environment analysis. Finally, consider and plan the implementation of these opportunities so they can meet the agency’s strategic goals or outcomes. Figure ‎11-2: Example agency improvement opportunities for various architectures
  • 251.
    251 National Overall ReferenceArchitecture (NORA) – Handbook 4. Summarize target architecture direction Summarize and organize findings such as agency’ EA vision, principles, etc., and analysis results, and define EA directions for building target architecture (as to business, application, data, and technology). Figure ‎11-3: Example of target architecture direction through overall analysis 5. Document and review Document all the information above into a summary with clear recommendations on the target architecture directions and the high-level schedules aligned with KSA and agency’s strategic targets. Carry out an internal review. It is also recommended that another party (for example the agency Strategic Planning Unit) review these target directions. 6. Obtain governance approval Present the summarized target architecture directions to the EA Governance Committee. Note that this will be the first useful EA output that the EA Governance will see. Thus, expect some questions and more ideas from the committee members. From their feedback, make the necessary updates and obtain their approval.
  • 252.
    252 National Overall ReferenceArchitecture (NORA) – Handbook 11.4.2 Step 7.2 Build target business architecture Description about the agency target BA On completion, the target BA will depict the future business landscape of the government agen- cy. Since the target BA is the future version of the current BA, both have the same artifacts or deliverables. The main difference is that the target BA describes about the future scenarios – i.e. providing solutions to the current issues and challenges. S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of BA 2 BA Principles The architectural principles of BA 3 Business Areas (BRM) The main business areas for the agency 4 Lines of Business (BRM) The main LoBs for the agency within the business areas 5 Business Functions (BRM) The key business function descriptions within LoBs 6 Sub-Business Functions (BRM) The sub-business function descriptions within each business function 7 Business Processes The target list of business process descriptions within each sub-business function; highlight new, improved and deleted processes 8 Organization Chart The target organization chart for the agency 9 Service Catalogue The target list of business services; highlight new, improved or deleted services Table ‎11-3: Target BA artifact descriptions Building the agency target BA Table 11-3 summarizes the main activities for building the agency target BA.
  • 253.
    253 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Activity Artifact / Deliverable 1 Review the BA purpose or direction and BA principles Reviewed / updated BA purpose or direction statement 2 Review the BA principles Reviewed / updated BA principles 3 Define the target business functions (BRM) Reviewed / updated business areas, LoBs, business functions and sub-business func- tions 4 Define the target business processes List of target improved business processes for the agency 5 Define the target service catalogue Target service catalogue 6 Document the target organization information Target organization chart 7 Document and review Reviewed draft target BA 8 Obtain governance approval Approved agency target BA Table ‎11-4: Activities to build target BA Using the target architecture directions as an input, do the following: 1. Review the BA purpose or direction Review the BA purpose or direction. The purpose should be applicable for the target BA. Make the necessary changes if required. 2. Review the BA principles Refer to the changes in the EA principles if any. Review and make the necessary changes if required. 3. Define the target business functions (BRM) Review the business areas, LoBs, business functions and sub-business functions. From the tar- get architecture directions, identify and analyze the areas of improvements such as removal of duplicated functions, improve customer service and improve business performance. Document the changes required especially for the business functions and sub-business functions.
  • 254.
    254 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎11-4: Example of updated business function in target BA 4. Define the target business processes From the above recommendations for target business functions and sub-business functions, review the affected processes that require change. Similarly, these processes include duplicated processes, and processes affected to improve customer service and business performance. Below is an example of updated business processes.
  • 255.
    255 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎11-5: Example of updated business processes in target BA 5. Define the target service catalogue Upon identification of the target business functions, sub-business functions and business processes, the EA Core and working teams have to identify all the current services affected. Analyze them and define the target services, i.e. new services, removal of duplicated services, joint or integrated a few services into one, and improve quality of services. 6. Document the target organization information Since business processes and business services will change, so does the staff and organization structure. Review and document the changes required for the target organization chart and related information. 7. Document and review Document all the above information according to the agency’s documentation standards. Do an internal review and updates. It is also advisable to get another party (especially the business owner and business teams) to carry out a final review.
  • 256.
    256 National Overall ReferenceArchitecture (NORA) – Handbook 8. Obtain governance approval With the completion of the above deliverables, present to the EA Governance Committee. The Chief Architect or Business Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval. 11.4.3 Step 7.3 Build target application architecture Description about the agency target AA On completion, the target AA will depict the future application landscape of the government agency. Since the target AA is the future version of the current AA, both have the same artifacts or deliverables. The main difference is that the target AA describes about the future scenarios – i.e. providing solutions to the current issues and challenges such as new application systems. S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of AA 2 AA Principles The architectural principles of AA 3 Application Systems (ARM) The main target application systems for the agency 4 Application Components (ARM) The key target application components for the agency 5 Application Interfaces (ARM) The main target application interfaces for the agency 6 Application Catalogue The target list of applications and their attributes 7 Application Functions The target description about the application functions 8 Application Relationships The target description about the application relation- ships 9 Application Overview The target overview description of the application systems Table ‎11-5: Target AA artifact descriptions
  • 257.
    257 National Overall ReferenceArchitecture (NORA) – Handbook Building the agency target AA Below table summarizes the main activities for building the agency target AA. S/No Activity Artifact / Deliverable 1 Define the AA purpose or direction Reviewed / updated AA purpose or direction statement 2 Define the AA principles Reviewed / updated AA principles 3 Define the target application systems, application components and application interfaces (ARM) Target application systems, application components and application interfaces 4 Document the target application overview Target application overview 5 Document the target application catalogue Target application catalogue 6 Document the target application func- tions and relationships Target application functions and application relationships 7 Document and review Reviewed draft target AA 8 Obtain governance approval Approved agency target AA Table ‎11-6: Activities to build target AA Using the target architecture directions as an input, do the following: 1. Review the AA purpose or direction Review the AA purpose or direction. The purpose should be applicable for the target AA. Make the necessary changes if required. 2. Review the AA principles Refer to the changes in the EA principles if any. Review and make the necessary changes if required.
  • 258.
    258 National Overall ReferenceArchitecture (NORA) – Handbook 3. Define the target application systems, application components and application interfaces (ARM) Review the current application systems, application components and applications interfaces. From the target BA, identify affected applications, components and interfaces that are required to support the future business landscapes. From the target architecture directions, further explore ways to improve sharing of application systems and components in the agency. In addition, explore ways to use national or govern- ment-wide application systems. Similarly, from the target architecture directions identify how future data usage will affect the applications. Find solutions to these data usage and exchange and update the target application systems, components and interfaces. Below is an example to identify new application systems. Figure ‎11-6: Example process to identify new application systems & architecture
  • 259.
    259 National Overall ReferenceArchitecture (NORA) – Handbook 4. Document the target application overview Once the target applications, components and interfaces have been identified, document them into the target application overview. This is a pictorial representation of the target applications for the government agency. 5. Document the target application catalogue Similarly, refer to the current application catalogue and update it to reflect the target state. Preferably, include the target application information such as application type (new, replace or retire) and the current business processes affected. Thus, the target application catalogue has to link with the target business processes and target service catalogue. 6. Document the target application functions and relationships From the list of target application systems, update the application functions and relationships. Typically, it is good to highlight the changes for the target information. Below is an example of the updated application function. Figure ‎11-7: Example of updated application function in target AA 7. Document and review With the completion of the various application documentation, consolidate them into one structured document according to the agency documentation standards. Carry out an internal review to verify all the data and artifacts. It is also recommended that an external or third party (for example application owners) carry out another review. Based on their feedback, make the necessary improvements.
  • 260.
    260 National Overall ReferenceArchitecture (NORA) – Handbook 8. Obtain governance approval With the completion of the above deliverables, present to the EA Governance Committee. The Chief Architect or Business Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval. 11.4.4 Step 7.4 Build target data architecture Description about the agency target DA On completion, the target DA will depict the future data landscape of the government agency. Since the target DA is the future version of the current DA, both have the same artifacts or deliverables. The main difference is that the target DA describes about the future scenarios – i.e. providing solutions to the current issues and challenges in terms of data usage and data exchange. S/No Artifact / Deliverable Description 1 Purpose / Direction The purpose of DA 2 DA Principles The architectural principles of DA 3 Data Model The main target data model for the agency 4 Data Classifications (DRM) The key target data classifications 5 Data Structure (DRM) The main target data structures for the agency 6 Data Exchange (DRM) The list of target data exchanges for the agency 7 Conceptual Data Model The target pictorial high-level description of data model for the agency 8 Logical Data Model The target logical data models of the agency 9 Data Flow Diagrams The various target pictorial representations of data flows for the agency 10 Database Portfolio Catalogue The target consolidation of all databases in the agency 11 Data Dictionary The target definitions for common data in the agency Table ‎11-7: Target DA artifact descriptions
  • 261.
    261 National Overall ReferenceArchitecture (NORA) – Handbook Building the agency target DA Below table summarizes the main activities for building the agency target DA. S/No Activity Artifact / Deliverable 1 Review the DA purpose or direction Reviewed / updated DA purpose or direction statement 2 Review the DA principles Reviewed / updated DA principles 3 Update data model, data classifications, data structures and data exchanges (DRM) Updated target data model, data classifications, data structures and data exchanges 4 Document the target conceptual and logi- cal data models Target conceptual data model and target logical data model 5 Document the target data flow diagrams Target data flow diagrams 6 Compile the target database portfolio catalogue Target database portfolio catalogue 7 Document the target data dictionary Target Data dictionary 8 Document and review Reviewed draft target DA 9 Obtain governance approval Approved agency target DA Table ‎11-8: Activities to build target DA Using the target architecture directions as an input, do the following: 1. Review the DA purpose or direction Review the DA purpose or direction. The purpose should be applicable for the target DA. Make the necessary changes if required. 2. Review DA principles Refer to the changes in the EA principles if any. Review and make the necessary changes if required.
  • 262.
    262 National Overall ReferenceArchitecture (NORA) – Handbook 3. Update data model, data classifications, data structures and data ex- changes (DRM) Review the data model, data classifications, data structures and data exchanges. With the new target architecture directions, identify artifacts that require update. With the changes in both the target BA and AA, it is normal that these artifacts collectively require change. The diagram below illustrates an example to identify and update the artifacts to reflect the future scenarios. Identify and make the necessary changes to reflect the future state for the data model, data classifications, data structures and data exchanges. Figure ‎11-8: Example of identified artifacts for updates in target DA 4. Document target conceptual and logical data models The target BA and AA will affect the target DA. With the updates done in the above step, there is a need to review and update the conceptual data model – for example, adding new data enti- ties and removing of current data entities. It is also necessary to review and update the logical data models to reflect the additional or changed data attributes and primary or secondary keys. 5. Document the target data flow diagrams This activity is to review and document the changes to the data flows. With the above changes, make the necessary updates to the current data flows. Highlight or associate the changes to the new data models, data entities, and even the new business processes and application systems.
  • 263.
    263 National Overall ReferenceArchitecture (NORA) – Handbook 6. Compile the target database portfolio catalogue A significant change would be to the database portfolio catalogue. Review the current cata- logue and compile the target catalogue. The diagram below is an example of the changes required to various databases. Figure ‎11-9: Example updated database diagram 7. Document the target data dictionary Finally, review the current data dictionary and update the documentation to reflect the target data dictionary. It is necessary to describe the difference in the data elements and definitions from current to target. 8. Document and review Upon completion of the above deliverables, document all the relevant information into a struc- tured target DA document base on the government agency’s documentation standards. Carry out an internal review and appropriate updates. It is also a good practice to get an external party to review the DA document such as DBAs and business owners.
  • 264.
    264 National Overall ReferenceArchitecture (NORA) – Handbook 9. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect or Data Architect should front this presenta- tion. From the comments from the committee, make the necessary changes to obtain their final approval. 11.4.5 Step 7.5 Build target technology architecture Description about the agency target TA On completion, the target TA will depict the future infrastructure landscape of the government agency. Since the target TA is the future version of the current TA, both have the same artifacts or deliverables. The main difference is that the target TA describes about the future scenarios – i.e. providing technology solutions to the current issues and challenges. S/ No Artifact / Deliverable Description 1 Purpose / Direction The purpose of TA 2 TRM Principles The architectural principles of TA 3 Service Area (TRM) The highest level technology service area 4 Service Category (TRM) The technology service category within a service area 5 Service Standard (TRM) The target list of technology service standards 6 Infrastructure Overview The target high-level representation of IT landscape in the government agency (normally in diagrammatic form) 7 Infrastructure Description The target descriptions of the main infrastructure technologies for future 8 Hardware Catalogue The list of hardware (no change; only when actual implementation) 9 Software Catalogue The list of software (no change; only when actual implementation) Table ‎11-9: Target TA artifact descriptions
  • 265.
    265 National Overall ReferenceArchitecture (NORA) – Handbook Building the agency target TA Table 11-10 summarizes the main activities for building the agency target TA. S/ No Activity Artifact / Deliverable 1 Review the TA purpose or direction Reviewed / updated TA purpose or di- rection statement 2 Review the TA principles Reviewed / updated TA principles 3 Review the service areas and service cat- egories (TRM) Reviewed service categories within ser- vice areas for the agency 4 Define the target service standards Target service standards within each service category relevant for agency 5 Describe the target infrastructure over- view High-level representation of target IT landscape in agency 6 Update the target infrastructure descrip- tions Target infrastructure technology de- scriptions and diagrams 7 Document and review Reviewed draft target TA 8 Obtain governance approval Approved agency target TA Table ‎11-10: Activities to build target TA Using the target architecture directions as an input, do the following: 1. Define the TA purpose or direction Review the TA purpose or direction. The purpose should be applicable for the target TA. Make the necessary changes if required. 2. Review TA principles Refer to the changes in the EA principles if any. Review and make the necessary changes if required.
  • 266.
    266 National Overall ReferenceArchitecture (NORA) – Handbook 3. Review the service areas and service categories (TRM) Review the service areas and categories to ensure that these are correct and relevant. From the target architecture directions, review if impact on the service areas and service categories. Typically, there will be some changes required. The diagram below shows an example of how the technology directions will affect the technology contents or service categories. Make the relevant changes to reflect the future state. Figure ‎11-10: Example of direction setting for in TA 4. Define the target service standards (TRM) Once the service areas and service categories have been updated, the EA Core and working teams have to define the target service standards that may include new standards or replacement of current standards. It is also necessary to define obsolete standards. 5. Describe the target infrastructure overview Compare the target service categories and standards with the current infrastructure overview diagram. Simple analysis would allow the team to identify transformation or improvement areas as shown in the example diagram below. Identify them and update the diagram into the target infrastructure overview.
  • 267.
    267 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎11-11: Example of updated infrastructure overview in target TA 6. Update the target infrastructure descriptions Review the current infrastructure descriptions. From the areas of improvements identified above, update the appropriate infrastructure descriptions. Note that in most cases the descriptions do not change much, but rather the corresponding technology diagrams that require updates. 7. Document and review After updating all the definitions and standards, document the relevant information into a structured information base on the agency’s documentation standards. Do an internal review and updates. It is also advisable to get another party (especially the technology and operations teams) to carry out a final review. 8. Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect or Technology Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 268.
    268 National Overall ReferenceArchitecture (NORA) – Handbook Stage8–Develop TransitionPlan
  • 269.
    269 National Overall ReferenceArchitecture (NORA) – Handbook 12. Stage 8 – Develop Transition Plan 12.1 Stage summary With the completion of the various target architectures in the previous stage, it is now important to plan and manage the transition required from the current landscapes to the desired target landscapes. There is a big gap between current and target architectures. If these are not managed through the transition plan, it is typical that the target architecture would not be realized. The transition plan is about defining and prioritizing intermediate activities, systems and projects in order to implement that future state of the target architectures. The major focus of this stage is to develop a detailed transition plan consisting of projects or activities, required resources, timeline and budget. Techniques such as ABC Analysis, Priority Analysis, ROI Analysis can be utilized in this stage. 12.2 Stage purpose The purpose of this stage to manage the transition between the current states to the target state. The expected outcomes or deliverables of this stage is: 1. Transition Plan. 12.3 Stage initiation With the completion of the previous stage, the EA Core and working teams have to ensure that the following deliverables are in place: 1. Target Business Architecture 2. Target Application Architecture 3. Target Data Architecture 4. Target Technology Architecture.
  • 270.
    270 National Overall ReferenceArchitecture (NORA) – Handbook Depending on the EA scope and development strategy, the government agency has to ensure that the corresponding target architectures are completed. If the government agency intends to build all architectures, then it needs the four above target architectures. However, if the government agency is doing a specific EA scope such as data and technology consolidation, then it needs to have at least the target data and technology architectures in place. 12.4 Key steps in stage 8 Below table list the key activities and expected deliverables for stage 7. Stage / Step No Description Deliverable 8 Develop Transition Plan Transition Plan 8.1 Define transition projects Transition project list 8.2 Prioritize transition projects Prioritized transition project list 8.3 Create transition roadmap Transition roadmap 8.4 Analyze and document required resources and outcomes Transition resource plan 8.5 Obtaining governance approval Approved transition roadmap and resource plan Table ‎12-1: Stage 8 steps 12.4.1 Step 8.1 Define transition projects This activity is about defining and prioritizing transition projects. S/No Activity Description 1. Define Ideas for Improvement Improvement ideas are defined by classifying them into business/application sectors or with agency’s core busi- ness functions 2. Define Transition Projects Transition projects are defined by listing up ideas for im- provement, a target architecture, and each architecture area. List transition projects from the current and target architecture gap analysis and complete the project list by adjusting and organizing them while consid- ering priority, sequence, etc. Table ‎12-2: Activities to define transition projects
  • 271.
    271 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎12-1: Example selection method for transition plan Figure ‎12-2: Example of transition project 12.4.2 Step 8.2 Prioritize transition projects After defining all the required transition projects, it is necessary to prioritize them. The table below lists the key activities to prioritize these projects.
  • 272.
    272 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Activity Description 1. Define Project Value • Define their values according to relationships be- tween projects, such as the project’s characteristics, importance, effectiveness etc. 2. Define Priorities • Prioritize them based on results of their validity and risk assessment with considering relationships between projects 3. Define Stages for Project • Based on projects and their priority assessment, define transition projects by stage Table ‎12-3: Activities to prioritize transition projects Figure ‎12-3: Example prioritization principles
  • 273.
    273 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎12-4: Example priority assessment structure Figure ‎12-5: Example priority assessment
  • 274.
    274 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎12-6: Example transition projects by stages 12.4.3 Step 8.3 Create transition roadmap Make EA transition roadmap according to the project’s priority, interface, and pre / post rela- tionships, and develop a detailed schedule by each project. S/ No Activity Description 1. Write project purposes in each stage Set an overall planning phase or stage (3 - 5 years) and define desired objectives by year 2. Write a transition project roadmap in each stage List up projects of higher priority in each stage Write it by mapping each transition project with each stage 3. Write a detailed schedule by each transition project Write a detail schedules for each project and its sub-projects Table ‎12-4: Activities to create transition roadmap
  • 275.
    275 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎12-7: Example of goal setting for each stage Figure ‎12-8: Example detailed schedule by each stage
  • 276.
    276 National Overall ReferenceArchitecture (NORA) – Handbook 12.4.5 Step 8.4 Analyze and document required resources and outcomes Estimate the required resources for all projects and analyze expected outcomes according to the EA project plan in each stage. S/ No Activity Description 1. Define a method of estimat- ing required resources Define type of required resources and an estima- tion method according to the type in order to de- duct required resources by each classification 2. Estimate required resources by each transition project Estimate required resources by each transition proj- ect according to their type 3. Estimate required resources by year Estimate required resources by year according to EA Transition roadmap in each stage 4. Define expected outcomes Write a detail schedules for each project and its sub-projects Table ‎12-5: Activities for estimating resources and outcomes Figure ‎12-9: Example resource estimation procedure
  • 277.
    277 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎12-10: Example required resource classification Figure ‎12-11: Example resource estimation Figure ‎12-12: Example resource requirements by stage
  • 278.
    278 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎12-13: Example expected outcome Some general considerations: • Although subject to the agency and their environment, it is normal to set a transition period to target architecture as 3 - 5 years. In this case, it is a good way to make “transition archi- tecture”, middle-stage of target architecture that can play role of a milestone to transition. • Because of a sudden change of business environment, technology development, etc. a transition plan as well as developed target architecture can be modified. Therefore, both target architecture and transition plan should be managed by EA. • Whether a transition plan is succeed or not depends on concreteness and realistic possibility of the plan. In other words, we should consider ‘is it reasonable when it comes to expense/ effectiveness analysis?’, ‘does it fully reflect users’ requirements on target architecture?’, ‘do agency’s stakeholders fully participate in developing transition plans and fully understand the contents?’ etc. • The transition to target environment does not happen rapidly, but is perform gradually by each architecture area or transition stage according to EA transition plan. Because of this, it takes much time to completely transit to target environment, and a transition process and
  • 279.
    279 National Overall ReferenceArchitecture (NORA) – Handbook transition elements are very complicated. Therefore, for successful transition, we should minimize risks against changes, protect investment, organize plans for secure transition, and reflect them on a transition plan. 12.4.5 Step 8.5 Obtain governance approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 280.
    280 National Overall ReferenceArchitecture (NORA) – Handbook Stage9–Develop ManagementPlan
  • 281.
    281 National Overall ReferenceArchitecture (NORA) – Handbook 13. Stage 9 – Develop Management Plan 13.1 Stage summary This stage is about developing the EA usage and management plans so that EA processes and val- ues become an integral part of the agency standard operating procedures. To ensure continued EA value delivery to the government agency, it is necessary and important to incorporate EA management plans into the government agency. 13.2 Stage purpose The purpose of this stage is to analyze and document the plan in ensuring the EA deliverables are accepted and use by the different stakeholders in the government agency. The expected outcomes or deliverables of this stage are: 1. EA usage plan 2. EA management plan 13.3 Stage initiation With the completion of the previous stage, the EA Core and working teams have to ensure that the following deliverables are in place: 1. Transition Roadmap 2. Transition Resource Plan. This stage is also a follow up on important policies or direction statements previously defined un- der Continuous Governance section – on particular, on EA usage and EA management directions.
  • 282.
    282 National Overall ReferenceArchitecture (NORA) – Handbook 13.4 Key steps in stage 9 The table below lists the key activities and expected deliverables for stage 9. Stage / Step No Description Deliverable 9 Develop Management Plan EA Usage and Management Plans 9.1 Develop EA usage plan EA usage plan 9.2 Develop EA management plan EA management plan 9.3 Obtaining Governance Approval Approved EA usage and management plans Table ‎13-1: Stage 9 steps Management and Governance Under the Continuous Governance section, the EA Governance Committee has set up clear directions on the EA usage and management plans. This stage will focus on the de- .velopment of these plans 13.4.1 Step 9.1 Develop EA usage plan It is an activity to specify EA usage ways by defining its purposes and scope through analyzing agency’s environment & possible users. The following are the activities to develop the EA usage plan. 1. Define Usage Purposes & Scope Based on EA usage policy or direction statements defined under governance section, the EA Core and working teams have to define the EA usage purposes & scope.
  • 283.
    283 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Activity Description 1.a Define usage purposes • Based on above Identifying, define usage purposes as to make them a common decision-making standard for achieving EA implementation purposes & expected outcomes • Above purposes are comprehensive. So, they also can be defined specifically, like core use purposes, supplementary use purposes, etc. 1.b Define usage scope • Based on above Identifying, define EA usage scope by grouping shared elements • EA usage scope of agencies doing EA demonstration project is defined as a IT life cycle, such as IT planning, IT project performing, IT operation, IT assessment, etc. Table ‎13-2: Activities to define EA usage purpose & scope Figure ‎13-1: Example for EA usage purposes
  • 284.
    284 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎13-2: Example for EA usage scope 2. Usage Plan Development In order that the agency performs practical IT projects using architecture information, they need guidelines that describe which each EA usage scenario can use the appropriate architecture infor- mation. Define EA usage process by each scope, in order that the EA supports common decision- makings while performing practical IT projects.
  • 285.
    285 National Overall ReferenceArchitecture (NORA) – Handbook S/ No Activity Description 2.a Define Usage tasks • Identify and define EA usage tasks based on its objectives and scope. 2.b Define possible users • Define directly/indirectly related-stakeholders with EA projects • Among stakeholders, Identify future EA users through holding internal meetings • Define EA user groups by classifying them with their roles, and define each group’s roles and responsibilities • In addition, define roles related to using architecture information 2.c Define Usage scenario • Write a business flow based on business activities and related organizations that are defined in usage tasks • Identify and define business activities which are required to use architecture information by each usage task • Define which architecture information can be used for doing each business activity. In other words, we can define the name and item of specific artifact. 2.d Develop Usage Guideline • Define a list for using EA information, and make a guideline • Based on usage scenario, write a guideline for fully using EA by each task. Table ‎13-3: Activities to define usage plan development
  • 286.
    286 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎13-3: Example for EA usage tasks User Main role Related organization Decision-Maker - A final decision-maker about business innovation, IT project promotion, and IT project policies The official in charge of IT IT Promotion Committee Architecture Review Commit- tee IT Investment Review Board IT Planning De- partment - Making mid and long term IT plans - Budgeting on unit information system development/ operation and assessing the results IT Planning Team Budget Planning Team Architecture Man- agement Depart- ment - Managing the information such as EA stan- dard, etc. Architecture Management Team Architecture Group User/ Business Department - As being in charge of agency’s businesses, they also offer requirements from users, etc. International Affairs Division Public Service Center
  • 287.
    287 National Overall ReferenceArchitecture (NORA) – Handbook User Main role Related organization IT Project Department - They are in charge of unit system develop- ment, from project planning to system development/ operation System Development Group System Maintenance Group System Development Department - Most of them are external agencies which are in charge of system development System Development Team System Operation Department - Most of them are external agencies which are in charge of system operation System Operation Team Table ‎13-4: Example for EA users Figure ‎13-5: Example for the relationship between EA tasks and artifacts 3. Obtaining Governance Approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect should front this presentation. From the com- ments from the committee, make the necessary changes to obtain their final approval.
  • 288.
    288 National Overall ReferenceArchitecture (NORA) – Handbook 13.4.2 Step 9.2 Develop EA management plan The value of EA is for it to be utilized when making decisions with using pertinent information and linkages. It is important to maintain accuracy and consistency of EA information; hence, EA management plan helps to maintain EA continuously by not only setting EA directions but also making EA management structure and EA management process. The following are the simple activities to develop the EA management plan. 1. Define EA Management Purposes & Scope Based on the EA management policy defined under governance, define EA management pur- poses & scopes, and develop EA management principles. S/ No Activity Description 1.a Define EA management purposes • Define EA management purpose which matches agency’s architecture purposes & directions from best practices 1.b Define EA management scope • Define EA management scope with considering EA project purposes, scope, principles, and purposes for EA use • Identify maintenance-needed-elements with referring to identified management scope • EA management targets are organizations, human resources, systems, application, architecture’s artifacts, etc. • Define the organization’s EA management scope with referring to above identified management scope and target elements • Check if developed EA management scope has omitted items by refer- ring to other agencies’ EA management scope and targets • Confirmed EA management scope in here includes defining an organization, management process, management support system, etc. 1.c Define EA management principles • Identify key management points for defining management principles (organization, competency, operation, methods for review, system, etc. • Define management principles by each management point which EA management plan should follow for achieving management purposes Table ‎13-5: Activities of EA management purposes & scope
  • 289.
    289 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎13-6: Example of EA management plan Figure ‎13-7: Example of EA management scope
  • 290.
    290 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎13-8: Example for EA management plan process Figure ‎13-9: Example for EA management plan principles
  • 291.
    291 National Overall ReferenceArchitecture (NORA) – Handbook 2. Develop EA Management Organization Define EA management organization’s structure & roles for maintaining EA, EA management process for following architecture principles and attaining architecture goals, and EA manage- ment support systems for supporting it. S/ No Activities Description 2.a EA management organization definition • Figure out management tasks and their required functions by checking management scope and targets • Based on management tasks and functions, figure out required organizations that can perform the tasks • If there are no related organizations that can perform the tasks, we can create a new organization • Based on the tasks and organizations, we can define their organizational structure by building up a decision-making structure for performing the tasks 2.b EA management organization’s roles definition • Analyze stakeholders of a management organizational structure, and identify their required roles • Define their roles that define responsibilities and authori- zation by the management organizational structure’s each organization • Based on roles, redefine the organizational structure, and make an institutional change plan Table ‎13-6: Activities to develop EA management organization
  • 292.
    292 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎13-10: Example for EA roles for large organization Figure ‎13-11: Example for architect tasks
  • 293.
    293 National Overall ReferenceArchitecture (NORA) – Handbook 3. Define EA Management Process In EA governance section, there are five aspects such as change, program, performance, capability, and policy management. In this section, it will provide more detail processes of EA management. S/ No Activity Description 3.a Define EA planning process • Define EA planning process by developing EA and reflecting any improvements of EA. 3.b Define EA change management process • Define EA change management process of maintaining and updating EA information • Define EA change management process which includes overall process from requesting, processing, to releasing changes • Architecture update: define a process of regular planning and target architecture designing for architecture improvements • Architecture change: define a process of reviewing and authorizing change requests • Architecture diffusion: a practical way of performing can be different according to an architecture diffusion target and channel. We can develop a process of planning, execution, and feedback for architecture diffusion • Architecture compliance review: develop a process of checking if it complies with ‘current architecture’ in IT system development project • Design for exceptions: develop a process of designing alternatives to the architecture, with which we can review validity of exceptions and applying them • Architecture-based IT system design: providing an outline of IT systems based on architecture and target architecture in order to support IT system development 3.c Define EA use support process • Define EA support process for smoothly sharing and using EA information
  • 294.
    294 National Overall ReferenceArchitecture (NORA) – Handbook 3.e Define a system management process • Define a process of managing and operating management systems used for maintaining EA information • Based on management system’s operating organizations, define a system operation process, such as system change process, system back-up process, etc. • Define a process with referring to a guideline for operating IT systems 3.f Define an assessment process • Define a process of assessing EA information’s use & man- agement • The agency can assess outcomes by themselves through de- veloping their own performance indicators with reference to performance reference model in EA development phase • Agency can assess agency’s EA maturity level with reference to EA maturity model that was made by Yesser (refer Annex E) Table ‎13-7: Activities to define EA management process Figure ‎13-12: Example for EA update process
  • 295.
    295 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎13-13: Example for EA change process Figure ‎13-14: Example for EA diffusion process
  • 296.
    296 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎13-15: Example for EA compliance review Figure ‎13-16: Example for EA design exception process
  • 297.
    297 National Overall ReferenceArchitecture (NORA) – Handbook Figure ‎13-17: Example for EA system design 4. Develop EA Management System Develop EA management system for continuously maintaining and using EA artifacts and EA- related information. S/No Activities Description 4.a Define requirements • Checking and organizing basic functions of management systems • Define a function of using EA artifacts information in terms of various tasks • Define a function of continuously maintaining EA artifacts information • Define a function of linking with management tools which are used for creating artifacts • Define a function of linking internal systemsㅡlinking assets management system, performance management system, and business management system, which are operated by the agency, themselves, with EA information • Define linking functions required to offer agency’s EA artifacts in- formation to national EA management system 4.b Build up a system • After defining system requirements, a system can be built based on them with using system development methodology. Development methodology can be referred to for system buildup. Table ‎13-8: Activities to define EA management system
  • 298.
    298 National Overall ReferenceArchitecture (NORA) – Handbook See below table of example requirements. Function Description Framework Management Managing a framework, a standard for managing agency’s EA systematically Meta-model Management Registering and managing standardized Meta-model to register artifacts Reference Model Management Registering and managing BRM, ARM, DRM, TRM, and PRM Artifact Management Registering and managing EA artifacts Architecture Analysis Analyzing architecture artifacts with various types System Management Managing system, such as user management, authoriza- tion management, etc. Table ‎13-9: Example for EA management system’s functions 5. Develop EA Management Guideline EA management guideline helps to update EA on the current status against changes of projects or IT systems, and is composed of management principles, organizations, and process. 6. Obtaining Governance Approval With the completion of the deliverables with the other above related contents, present to the EA Governance Committee. The Chief Architect should front this presentation. From the comments from the committee, make the necessary changes to obtain their final approval.
  • 299.
    299 National Overall ReferenceArchitecture (NORA) – Handbook Stage10–Execute andMaintain
  • 300.
    300 National Overall ReferenceArchitecture (NORA) – Handbook 14. Stage 10 – Execute and Maintain 14.1 Stage Summary This is the last stage where a government agency executes and maintains its EA. Having cov- ered many stages in the EA journey, this last stage concerns with taking actions to make the government agency’s EA into a reality. 14.2 Stage Purpose The purpose of this stage is to finally implement the EA artifacts that were documented in the previous stages. The following are the expected outcomes of this stage: 1. Promote or market the government agency’s EA so that government employees are aware of the usefulness of EA 2. Train some employees on the using and maintaining the various information related to EA 3. Execute or implement the EA including the management of the transition activities 14.3 Stage Initiation With the completion of the previous stages, the EA Core Team and working teams have to en- sure that the following deliverables, in addition to the target architectures, are in place: 1. EA Management Plan 2. EA Usage Plan 3. EA Transition Plan With all the above plans, the EA Core Team and working teams can start the execution phase.
  • 301.
    301 National Overall ReferenceArchitecture (NORA) – Handbook 14.4 Key Steps in Stage 10 The last stage is the final challenge for the EA Core team and working team members to materialize their previous efforts. The key steps in Stage 10 are shown in Table 14-1. Stage / Step No Description Deliverable 10 Execute and Maintain 10.1 Implement the EA Usage & Management Plan Project/Program Management Deliverables 10.2 Implement the EA Transition Roadmap Project/Program Management Deliverables Table ‎14-1: Stage 10 steps 14.4.1 Step 10.1 Implement the EA usage & management plan Another challenge for the EA Core team and working teams is the actual implementation of the EA usage & management plan that was prepared in the previous phase. It is one thing to prepare the plan, but it requires effort and coordination to actually implement the EA usage & management Plan. This is where all the organization, systems, resources and the governance/ management processes are implemented in a coordinated manner. The EA Core team has to ensure that the EA usage & management plan are executed according to the details in the plan. To some extent, some of the areas in the plan have been covered or described in the steps above such as EA governance / management including the change man- agement aspect. A few important things to note are:
  • 302.
    302 National Overall ReferenceArchitecture (NORA) – Handbook 1. Institutionalization the usage & management plan It’s required to make EA usage & management guideline mandatory in order to continuously manage and use EA and make an internal notice of whether the guideline is followed to all organizations. Figure ‎14-1: Example for EA usage guideline
  • 303.
    303 National Overall ReferenceArchitecture (NORA) – Handbook Table ‎14-2: Example for EA management guideline 2. EA usage and management plan execution We can use EA at work based on the EA usage and management guideline. All EA information and related artifacts should be regularly or instantly updated as change management process after that we can execute EA plans smoothly. In case EA system has been developed, we can derive and use EA information from it based on EA use scenario. 3. EA usage and management plan supervision EA team’s manager can supervise the status of EA operation and usage according to EA guidelines. Continuously monitor whether EA management processes and EA usage sce- narios are being well obeyed. In case EA system has been developed, we can figure out EA utilization status by using statistics, etc. from the EA system.
  • 304.
    304 National Overall ReferenceArchitecture (NORA) – Handbook 4. EA usage and management plan assessment Define assessment elements to evaluate EA usage and management plans and regularly (once a year) conduct assessments by investigating and interviewing stakeholders. Elements Key contents Compliance 1 Have all the usage & management tasks specified in EA guidelines been applied at work? Check them by making a list of usage & management tasks in EA guidelines T/F 2 Has architecture information been updated according to EA usage & management process? Check them by making a list of architecture information to be updated T/F 3 Does the person in charge use/follow EA usage/management procedures regarding to their tasks? Check them by making a list of usage & management tasks T/F Compatibility 1 Is EA usage & management process correct? Check them by making a list of EA usage & management processes T/F 2 Is architecture information updated according to a usage & management process correct? Check them by making a list of architecture information by each EA us- age & management task T/F Convenience 1 Isn’t EA usage & management process complicated? Check them by making a list of EA usage & management tasks T/F 2 Does it take too much time to process EA usage & management tasks? Measure time of processing each EA usage & management tasks T/F 3 Is it easy to update EA information according to each usage & management tasks? Can use 1-5 point scale 4 What’s satisfaction level caused by utilizing & managing EA? Can use 1-5 point scale Table ‎14-3: Example for EA usage & management plan assessment
  • 305.
    305 National Overall ReferenceArchitecture (NORA) – Handbook 5. EA usage and management plan improvement Based on the results of EA usage & management plan assessment, its improvement directions can be defined and EA usage & management plan can be supplemented and enhanced. 14.4.2 Step 10.2 Implement the EA transition roadmap The transition of EA from the current state to the eventual target is a challenging task, but with great satisfaction when it is completed successfully. In the implementation of the EA Transition Roadmap, the EA Core team and working teams have to act as coordinators (between projects and divisions) and advisors (on what the project owners should do and when). While the previous step tackles all the management / governance areas, this step focuses on the basic steps to implement the transition projects and activities. With the EA Transition Road- map prepared in the previous phase, the implementation of this roadmap has three main activi- ties as follows: 1. Review and update the EA Transition Roadmap Since the EA Transition Roadmap was prepared and approved, there are many activities such as conducting awareness sessions, presentation to the stakeholders and discussions on new ini- tiatives. Over time, some of these discussions could spin off other projects or affect the original schedule and priority of the projects in the transition roadmap. It is necessary, therefore, to review and update the EA Transition Roadmap from various feedback, suggestions and new directives from top management. The following are recommended activities: a. Add, update or remove the projects identified; if need be, re-prioritized the whole list of projects b. For each project, identify and confirm the project owner. In addition, check the resources and schedules are reasonable. If not, update the resources required and time needed to complete the projects c. Update the Transition Roadmap. If major updates were done, get approval from the EA Gov- ernance Committee d. Also update the Program Management Plan correspondingly.
  • 306.
    306 National Overall ReferenceArchitecture (NORA) – Handbook 2.Assign projects to Project Owners With the approved updated EA Transition Roadmap, the EA Core team has to inform and assign the projects to the respective project owners. It is recommended that each project carry out the following: a. Formation of Project Team (Project Owner, Project Manager and Project Members) b. Briefing to the Project Team by the EA Core Team on expected deliverables and resources provided c. Formalize communication channel for Project Team to update and report progress to the EA Program Manager. Key Performance Indicators (PKIs) have to be established so that the EA Transition Roadmap can be tracked and the overall progress can be updated to the EA Gov- ernance Committee. 3.Track and report progress of transition Last but not the least, all the projects and major activities in the EA Transition Roadmap have to be tracked. For consistent, good program management and tracking of the various projects, the following are recommended: a. Centralize all reporting into a management dashboard if possible b. Determine flags or indicators to measure project progress – i.e. % completion and green, amber or red flags c. Occasionally, review the EA program management and link to the relevant EA governance / management areas in previous step. There may also be a need to update the EA artifacts as the various projects progress (see next step).
  • 307.
    307 National Overall ReferenceArchitecture (NORA) – Handbook Annex A: NORA Summary of Deliverables by Stages The following tables summarize the deliverables within the different stages of NORA. STAGE 1: Develop EA Project Strategy Item Description Summary This stage describes the key activities to research, plan and obtain approval to embark on the EA project. Each government agency has to obtain its project funding and to either develop its EA internally or outsource. Purpose Lay the foundation of a government agency’s EA implementation journey with clear directions and commitments. Initiation Yesser will communicate with the e-Transformation Committee in each government agency to initiate the agency EA implementation. Govern- ment agencies can also request and discuss with Yesser to initiate their EA program. Table ‎14-4: Stage 1 summary
  • 308.
    308 National Overall ReferenceArchitecture (NORA) – Handbook Stage / Step No Description Deliverable 1 Develop EA Project Strategy Government Agency’s EA Project Strategy 1.1 Analyze EA trends and case studies (both international and local agencies; also across same line of business / segment) Document relevant EA trends and case studies relating to the government agency 1.2 Provide EA awareness to government agency’s business and IT leaders (Government agencies can invite Yesser to brief on NEA) Understand the importance of EA 1.3 Assess government agency’s e-transformation maturity (Via Qiyas) and its alignment of IT to the government business Submit and present the assessment report to the e-Transformation Committee or equivalent. The assessment shall describe the agency’s: 1. Maturity of its e-transformation 2. Effectiveness of its business functions 3. Maturity on IT adoption 4. Organization capability on business productivity and use of IT. 1.4 Document government agency’s EA project strategy Draft Government Agency’s EA Project Strategy 1.5 Present and obtain approval for the EA project strategy Approved Government Agency’s EA Project Strategy by its e-Transformation Committee or equivalent Table ‎14-5: Stage 1 steps
  • 309.
    309 National Overall ReferenceArchitecture (NORA) – Handbook STAGE 2: Develop EA Project Plan Item Description Summary Having established an approved EA Project Strategy, the government agency has to carry out the detailed plan for the EA project. This stage describes the key activities involved in developing and obtaining approval for the EA project. Purpose The government agency has to structure and form appropriate EA team(s) and develop the detailed EA project plan. Initiation This stage begins with the endorsement or approval of the EA Project Strategy in Stage 1. Table ‎14-6: Stage 2 summary Stage / Step No Description Deliverable 2 Develop EA Project Plan Government Agency’s EA Project Plan 2.1 Upon approval of the Project Strategy (Step 1.4), propose and set up the various EA committees and teams such as EA Governance Committee, EA Working Team, Business-Domain Working Team and the IT Working Team. Approved EA committees and working teams by the e-Transformation Committee or equivalent 2.2 Finalize the EA development approach such as scope, budget, schedule, and including outsourc- ing or insourcing of the Government Agency’s EA implementation. Also include the adoption of EA culture into all aspects of business and IT plan- ning and reviews Approved EA development approach by e- transformation committee or equivalent 2.3 Upon approval of Steps 2.1 & 2.2, the EA working team will document the detailed EA Project Plan Draft EA project plan 2.4 Present and obtain approval for the EA project plan Approved EA project plan by the EA Gover- nance Committee Table ‎14-7: Stage 2 steps
  • 310.
    310 National Overall ReferenceArchitecture (NORA) – Handbook Continuous Governance Item Description Summary As EA is a massive and long-term project, there are bound to be many challenges and issues. It is vital, therefore, that the EA governance work is also address to ensure the suc- cess of the project. Purpose The previous stage has defined he roles and responsibilities of the EA Governance Committee. Hence, the purpose of the EA governance is very clear, i.e. to steer and direct the EA project to successfully meet the government agency’s vision, mission and strategic goals. Initiation The government agency’s e-Transformation Committee started the governance by reviewing and approving the EA Project Strategy in Stage 1. The EA governance officially started with the formation of the EA Governance Committee in Stage 2. Note that the EA governance is a continuous activity affecting all stages. Table ‎14-8: Continuous governance summary Stage / Step No Description Deliverable All Continuous Governance Success of Government Agency’s EA Project 1. Track and monitor the key activities and deliverables of the EA. Highlight to EA Governance Committee on potential delays, changes in scope, and lack of re- sources Program management of Government Agency’s EA implementation 2. Manage the introduction and changes to the vari- ous activities in the EA. In particular, carry out ac- tivities on EA awareness and promotion Change management especially on awareness and promotion of Government Agency’s EA 3. Manage the capability requirements for the EA implementation that includes training, changes to job scope, and review of division / department or- ganizational structures Capability management on the progression on the government agency’s capabilities to carry out the EA plans 4. Manage the policies and regulations required to implement the different factors or activities of the EA in the government agency Policy management on the policies and regu- lations relating to the EA execution 5. Manage the performance outcomes of the EA in the government agency Performance management on the metrics, KPIs and outcomes of the EA Table ‎14-9: Continuous governance steps
  • 311.
    311 National Overall ReferenceArchitecture (NORA) – Handbook STAGE 3: Analyze Current State Item Description Summary With the approved EA project plan in place, the EA Core and working teams can start the actual work by analyzing the current state of the government agency. This stage describes the key activities in reviewing and analyzing the different aspects of the current state of the government agency. Purpose The government agency has to carry out requirements study and detailed analysis of the current state in terms of both business and IT. Initiation This stage begins with the endorsement or approval of the EA Project Plan from Stage 2. Table ‎14-10: Stage 3 summary Stage / Step No Description Deliverable 3 Analyze Current Stage a. EA Requirements b. EA Environment Analysis Reports (Current Business Landscape and Current IT Landscape) c. SWOT Analysis Report 3.1 Gather and document EA require- ments from various stakeholders such as e-Transformation Committee, EA Governance Committee, main business functions’ stakeholders, and EA working teams Government Agency’s EA requirements re- viewed by EA Governance Committee 3.2 Gather and analyze Government Agency’s internal environment such as organizational capability to plan and execute e-transformation plan, busi- ness plan and IT plan Government Agency’s EA environment analysis report reviewed by EA Gover- nance Committee
  • 312.
    312 National Overall ReferenceArchitecture (NORA) – Handbook 3.3 Gather and analyze Government Agen- cy’s external environment such as gener- al trends in EA, United Nations or similar e-Government rankings including recom- mendations, prioritized national projects and new government policies Government Agency’s EA environment analysis report reviewed by EA Gover- nance Committee 3.4 Present to the EA Governance Committee EA Governance Committee is informed about the detailed current state of the government agency Table ‎14-11: Stage 3 steps STAGE 4: Develop EA Framework Item Description Summary This is the stage where a government agency starts to develop its EA. In this stage, the government agency constructs the main pillars such as EA vision & mission, architecture goals & principles, EA Framework, taxonomy, and other related standards that is fundamental to its EA jour- ney. The government agency should focus on building quality EA framework and other relevant processes. Purpose The previous stage gave the EA requirements and environment analysis reports so that the EA team knows what the government agency’s EA has to address. The purpose of stage 4 is to architect important EA fundamentals that will steer and guide the EA development in subsequent stages. Initiation This stage begins with the completed EA requirements, environment analysis reports (both current business and current IT landscapes) and the SWOT analysis report from Stage 3. Note that the EA Governance Committee may also provide additional strategic requirements at the end of Stage 3. Table ‎14-12: Stage 4 summary
  • 313.
    313 National Overall ReferenceArchitecture (NORA) – Handbook Stage / Step No Description Deliverable 4 Develop EA Framework Government Agency’s EA Mission, Vision, Architecture Objectives and Architecture Principle Statements Government Agency’s EA Framework 4.1 Analyze the EA requirements and findings from the environment report to address the gaps. These gaps would address what is currently missing and also what is required to meet future needs Document gaps i.e. EA requirements and environment improvements needed 4.2 Carry out questionnaire and/or brainstorming ses- sions with key stakeholders to define the EA vision, mission, architecture objectives and architecture principles (these statements have to address gaps identified in Step 2-1) Draft EA Vision, Mission, Architecture Objectives and Architecture Principles 4.3 Present and obtain approval from EA Governance Committee Approved EA Vision, Mission, Archi- tecture Objectives and Architecture Principles 4.4 From the EA Vision, mission, architecture objectives and principles, define the EA framework structure Draft EA Framework Structure 4.5 With the EA framework in place, design the archi- tecture elements Draft EA Architecture Elements 4.6 Fill up the framework by defining the EA Model and the relationships between elements Draft EA Model 4.7 To standardize the EA documents, create the EA documentation standard Draft EA Documentation Standard 4.8 Similarly, to ensure quality, define the EA artifact management processes Draft EA Artifact management pro- cesses 4.9 Present the outputs from 4.4 to 4.8 and obtain ap- proval from EA Governance Committee Approved EA Framework Table ‎14-13: Stage 4 steps
  • 314.
    314 National Overall ReferenceArchitecture (NORA) – Handbook STAGE 5: Build Reference Models Item Description Summary The previous section has defined and described the reference models and architectures. Based on the EA framework developed previously, this stage is all about building the reference models so that a government agency can have standard views and taxonomies of key organizational assets and processes such as business, application, data and technology domains. Purpose The purpose of stage 5 is to architect and build the relevant EA reference models of the government agency. Initiation This stage requires the EA vision, mission, architecture goals & principles, and the EA framework from the previous stage. In addition, the government agency needs to refer to Yesser’s NEA Reference Models. By referring to the NEA refer- ence models, the government agency can develop their own reference models ensuring alignment with whole of government as well as to achieve its EA goals. Table ‎14-14: Stage 5 summary
  • 315.
    315 National Overall ReferenceArchitecture (NORA) – Handbook Stage / Step No Description Deliverable 5 Document Government Agency’s Reference Models Government Agency’s Reference Models 5.1 Develop a model that standardizes perfor- mance elements for improving IT projects and their quality. Obtain approval from the EA Governance Committee Approved Performance Reference Model 5.2 Develop a model that classifies and defines business functions and related information. Obtain approval from the EA Governance Committee Approved Business Reference Model 5.3 Develop a model that classifies and defines shared application systems/components to promote service integration and reuse by identifying redundant or correlated appli- cations. Obtain approval from the EA Gov- ernance Committee Approved Application Reference Model 5.4 Develop a model that classifies data and defines standard data structures to support data architecture development, data stan- dard, and data reuse. Obtain approval from the EA Governance Committee Approved Data Reference Model 5.5 Develop a model that classifies and defines technologies and technology standards/ specifications, which support business and services. Obtain approval from the EA Governance Committee Approved Technology Reference Model Table ‎14-15: Stage 5 steps
  • 316.
    316 National Overall ReferenceArchitecture (NORA) – Handbook STAGE 6: Build Current Architecture Item Description Summary The focus of this stage is in capturing the current architectures of the government agency so that the agency can clearly understand its IT and business landscapes. This would allow a better visibility of the interconnections among different architectures and components, and aid in analyzing the agency’s issues, challenges and opportuni- ties relating to business, information/data and technologies. Purpose The purpose of this stage is to analyze and document the status of the current govern- ment agency’s IT and business landscapes. Initiation The completion of the relevant reference models from the previous stage. Table ‎14-16: Stage 6 summary Stage / Step No Description Deliverable 6 Build Government Agency’s Current Architectures Government Agency’s Relevant Current Ar- chitectures 6.1 Capture current business and IT data Government Agency’s Current Data 6.2 Analyze and build the business architecture that describes the current business functions, sub- business functions, business processes, business activities and business services Government Agency’s Current Business Ar- chitecture 6.3 Analyze and build the application architecture that lists all the current applications (fully auto- mated, partial automated & manual), and the relationships between these applications and the business functions / processes / services Government Agency’s Current Application Architecture 6.4 Analyze and build the data architecture that shows all the current data used by the govern- ment agency, the usage of data by applications including data exchange within and externally Government Agency’s Current Data Archi- tecture 6.5 Analyze and build the technology architecture that illustrates the current IT infrastructure used by the various applications, data and people Government Agency’s Current Technology Architecture 6.6 Current Architecture Analysis Summary of Improvement Opportunities Table ‎14-17: Stage 6 steps
  • 317.
    317 National Overall ReferenceArchitecture (NORA) – Handbook STAGE 7: Build Target Architecture Item Description Summary With the completion of the government agency’s current architectures, this stage de- velops the target architectures. As a blueprint for the government agency to realize its goals and desired outcomes in 3 to 5 years, the target architecture defines the improved business and IT landscapes. Purpose The purpose of this stage is to analyze, design and document the target government agency’s IT and business landscapes. Initiation The completion of the relevant current architectures from the previous stage. Table ‎14-18: Stage 7 summary Stage / Step No Description Deliverable 7 Build Government Agency’s Target Architectures Government Agency’s Relevant Target Architectures 7.1 Define directions for developing target architecture by analyzing environmental factors such as agency’s vision/principles, current architectures etc. Target Architecture direction 7.2 Analyze and build the target business architecture based on architecture principles, current business architecture’s analysis result, and current business architecture deliverables. Government Agency’s target Business Architecture 7.3 Analyze and build the target application architecture based on architecture principles, current application architecture’s analysis result, and current application architecture deliverables. Government Agency’s target Application Architecture 7.4 Analyze and build the target data architecture based on architecture principles, current data architec- ture’s analysis result, and current data architecture deliverables. Government Agency’s target Data Architecture 7.5 Analyze and build the target technology architecture based on architecture principles, current technology architecture’s analysis result, and current technology ar- chitecture deliverables. Government Agency’s target Technology Architecture Table ‎14-19: Stage 7 steps
  • 318.
    318 National Overall ReferenceArchitecture (NORA) – Handbook STAGE 8: Develop Transition Plan Item Description Summary With the completion of the various target architectures in the previous stage, it is now important to plan and manage the transition required from the current landscapes to the desired target landscapes. Purpose The purpose of this stage to manage the transition between the current state to the target state. Initiation The completion of the relevant target architectures from the previous stage. Table ‎14-20: Stage 8 summary Stage / Step No Description Deliverable 8 Develop Transition Plan Transition Plan 8.1 Define transition projects Transition project list 8.2 Prioritize transition projects Prioritized transition project list 8.3 Create transition roadmap Transition roadmap 8.4 Analyze and document required re- sources and outcomes Transition resource plan 8.5 Obtaining governance approval Approved transition roadmap and re- source plan Table ‎14-21: Stage 8 steps
  • 319.
    319 National Overall ReferenceArchitecture (NORA) – Handbook STAGE 9: Develop Management Plan Item Description Summary This stage is about developing the EA usage and management plans so that EA processes and values become an integral part of the agency standard operating procedures. To ensure continued EA value delivery to the government agency, it is necessary and important to incorporate EA management plans into the gov- ernment agency. Purpose The purpose of this stage is to analyze and document the plan in ensur- ing the EA deliverables are accepted and use by the different stakehold- ers in the government agency. Initiation The completion of the activities in the transition stage. Table ‎14-22: Stage 9 summary Stage / Step No Description Deliverable 9 Develop Management Plan Management Plans 9.1 Develop EA usage plan EA usage plan 9.2 Develop EA management plan EA management plan 9.3 Obtaining governance approval Approved EA usage and management plans Table ‎14-23: Stage 9 steps STAGE 10: Execute and Maintain Item Description Summary This is the last stage where a government agency executes and maintains its EA. Having covered many stages in the EA journey, this last stage concerns with taking actions to make the government agency’s EA into a reality. Purpose The purpose of this stage is to implement the EA artifacts that were docu- mented in the previous stages. Initiation The completion of the activities in the previous management stage. Table ‎14-24: Stage 10 summary
  • 320.
    320 National Overall ReferenceArchitecture (NORA) – Handbook Stage / Step No Description Deliverable 10 Execute and Maintain On-going maintenance of the Government Agency’s EA 10.1 Implement the EA Usage & Management Plan Nil 10.2 Implement the EA Transition Roadmap Nil Table ‎14-25: Stage 10 steps
  • 321.
    321 National Overall ReferenceArchitecture (NORA) – Handbook Annex B: NEA System and EAMS Government agencies have mandate to fulfill and deliver excellent services concentrated on a particular vertical. The single-minded focus of the government agency in delivering on their ver- tical is paramount for success of government. However, there is a need for bringing a whole of government view, not only for the coherency of government but also to improve on efficiency and effectiveness across all verticals. The NEA system can be defined as a central national repository use for the purpose of captur- ing and facilitating a whole of government view. The goals and objectives for the NEA System is listed below. Goals The goal of this project is to build and operate a NEA system repository that aimed at achiev- ing NEA Goals and Objectives. This is realized by capturing the information outlined in the NEA Meta model covering elements of Business and IT. Objectives 1. Implement NEA repository system to assist in whole-of-government IT planning 2. Facilitate identification of areas for reuse of services, components, systems etc. 3. Capturing the big picture of whole-of-government IT landscape and IT assets. B1. NEA System Overview The following system context is used to represent the relevant systems and the key users from a context point of view, they do not include the details regarding the exact type of systems being used to provide the required functionality. The purpose of the below diagram is to illustrate the possible systems/users that is part of the solution.
  • 322.
    322 National Overall ReferenceArchitecture (NORA) – Handbook NEA Repository system Agency User HTTPS Agency EA System NEA System Admin API NEA Meta-Model HTTPS CSV Excel NEA Member HTTPS Public User HTTPS NEA Data Analyst HTTPS Planning System Procurement System Budget System Audit System National Project System API E Gov Action Plan BRM ARM DRM Business Service Transf Plan IT Project App Systm Sys Fnct Software Hardware NEA Maturity Model Workflow Service Repository E Forms CRM Qiyas System API - Sync Saudi Portal Yesser Portal Existing Yesser Systems Import WS WS WS NEA Portal Figure ‎14-2: NEA System Context Following are the key elements from the System Context and their purpose in the NEA System. Agency User: - User from Agency. Agency EA System: - EA Management system from an Agency. Public User: - Individual Users who has access to the public information in NEA Repository External Systems: The NEA repository system needs to interact with other external systems to gather specific information, such other systems are systems related to Planning, Budgeting, Procurement, Audit and National Projects etc. GSB: Yesser has established GSB in order to facilitate integration and exchange of shared gov- ernment data among various agencies interlinking with GSB. Considering dependency of gov- ernment services that necessitate interlinking and integration of each agency with other agen- cies in order to deliver a particular service, GSB plays a pivotal role in facilitating business and technology integration among government agencies Other Existing Yesser Systems:
  • 323.
    323 National Overall ReferenceArchitecture (NORA) – Handbook Other related Yesser systems and the relevant information with respect to NEA repository are listed below: 1. Service Repository: The Service repository holds the information regarding the core services de- livered by the Government Agencies 2. Qiyas System: This system is used to measure the e-Transformation across all the government agencies 3. E Forms: Agencies utilize the E Forms system to request services like fund request from Yesser 4. CRM: The CRM system for Yesser, the system is Microsoft CRM 5. Saudi Portal: It is the national portal of KSA, it also holds the information regarding Services of- fered by government agencies, in addition to other relevant information. 6. Yesser Portal: The portal exposes services from Yesser provided to the government agencies. B2.Agency EAMS The EA Management System or EAMS is an important component in the NEA Repository system context. Most agencies would prefer to keep their agency-wide information in an EAMS. This would make it convenient for the agency to extract information from its own EAMS and contribute towards whole of government view within the NEA Repository. The information from EAMS can be sent to the NEA System either by using appropriate API’s or via exporting data from the EAMS and importing it into NEA System.
  • 324.
    324 National Overall ReferenceArchitecture (NORA) – Handbook Annex C: NEA Meta-Model C1. Overview of NEA Meta-model NEA Meta-model comprises of national and agency level elements. The national level elements try to capture information for whole of government approach from strategic, business, technol- ogy and data point of view. Agencies provide information regarding similar aspects addressing the scope at agency level. The elements are linked together strategically as well as taxonomi- cally to provide end-to-end visibility to the e-Government ecosystem. Agency E- transformation plan Business service(SRS) IT project Application system Data HardwareSoftware Objectives DRM ARM Data Centre Figure ‎14-3: NEA Meta-Model
  • 325.
    325 National Overall ReferenceArchitecture (NORA) – Handbook C2. Objectives of NEA Meta-Model The primary objective of NEA Meta-model 1.0 is to define a whole-of-government national Meta-model and toward establishing a whole-of-government architecture. Other objectives are as listed below: 1. Enhancing understanding about agency’s EA components and standard related information 2. Proposing necessary items that agency should apply in order to link agency’s EA information with whole-of-government NEA 3. Capturing the current architecture of whole-of-government at the same time keeping it minimal- istic demands for agencies 4. Providing sufficient linkages to ensure consistency 5. Flexibility to accommodate more elements in future as need arises.
  • 326.
    326 National Overall ReferenceArchitecture (NORA) – Handbook C3. NEA Meta-Model Classes Component Property Item Domain Domain Restric- tion Explanation Agency e-Transformation Plan ID ID ID Name Name Name of Agency e-Transfor- mation plan Description Content Detailed description of Agency E-transformation plan Planned Start Month Date Planned End Month Date Budget Currency Budget allocated for this Plan Objective ID ID ID of Objective Objective Name Objective Description Content Detailed description of Objective Related items Agency e-Transformation Plan Agency e-Transfor- mation Plan ID RefID IT Project Name Name Name of IT project Description Content Detailed description of IT project MoF Project code Code MoF Project code Type Enum Consultation Development Purchasing Maintenance & Operation Licensing Others All project types rather than the above ⓞ Other types Content Detailed contents in case IT project type is others Status Code In preparation Ongoing Close
  • 327.
    327 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Start month Month/ Year MM/YYYY Project start month/year in Gregorian Ex) 05/2013 End month Month/ Year MM/YYYY Project end month/year in Gregorian Ex) 05/2014 Project Owner Ex) Yesser, MCIT, etc. Related items Agency e-Transformation Plan Agency e-Transfor- mation Plan ID RefID Objective Objective ID RefID Application system Name Name Name of App system Ex) ERP system, HR system Introduction method Enum Purchase Classification of App, sys- tem’s introduction method Dissemination from other agencies Outsourcing Development Self-Development Others ⓞ Other methods Content Detailed contents in case introduction method is others Purpose Content Objective of common system’s introduction ※reason for being devel- oped, for which business it was developed, etc Development Year Year YYYY Initial development year of Application system in Gregorian Ex) 2010 Development language Code Java Programming Language or Development tool used to build this application C, C++, .net Oracle Developer/ADF PHP Others Development Language Version Version Development Language Version
  • 328.
    328 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Other lan- guages Contents Detailed contents in case Development language is others Application Domain Enum Acquisition Management Customer Service Emergency Management Financial Management Grants Management Workforce Management Human Resource Manage- ment Legal Physical Safety Property and Asset Manage- ment Security Management Systems Management Application User Interface Enum Web Based Application Window Based Application Others Type of Ser- vice Delivered Enum Core Business Services Supportive Business Services Internal Use Only ⓞ Related Law Name The name of App. system related Law Total develop- ment cost Number SAR Total cost of App. system development excluding hardware and software Ex) 100,000 SAR Annual main- tenance cost Number SAR Total cost of App. system maintenance excluding hardware and software maintenance Ex) 100,000 SAR
  • 329.
    329 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Cloud Plan Enum Yes Weather App. system has cloud plan or not No Already adopted Don’t know Relationships Data Name Hardware Name Software Name IT project Name Busi- ness ser- vice Name Hardware Name Type Enum Server Type of introduced hard- ware Storage Security tool Backup Tool Others ⓞ Other types Content Writing down relevant de- tailed contents in case the type of hardware is others Ex) L4 switch, Scanner etc.
  • 330.
    330 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Hardware ⓞDetailed type of hardware Enum Serv- er Unix NT(Windows) Linux Mainframe Others Stor- age SAN Storage NAS Storage Others Secu- rity tool Firewall IPS/IDS VPN DDos Others Back- up Tool Tape library VTL Others Oth- ers Vender Enum HP Name of hardware manu- facturer (writing down manufacturer’s name, not supplier’s name) IBM SUN FUJITSU DELL HITACHI INTEL EMC HITACHI BROCADE McDATA ADIC Overland Quantum Others Model name Name Name of hardware named by its manufacturer
  • 331.
    331 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Hardware OS name Enum AIX Name of OS loaded in hardware Linux Windows HP Unix Solaris Others ⓞ Other OS names Content Writing down OS name in case OS name is others Introduction year Year YYYY Writing down the year when the machine is in- stalled in Gregorian year Ex) 2009 Business Severity Enum Mission Critical Critical Medium Low Total cost Number SAR Total cost of the hardware installation Ex) 100,000 SAR Annual main- tenance cost Number SAR The cost of hardware an- nual maintenance cost Ex) 100,000 SAR Software Name Name Software means common use or sharing software ※ inputting it with the form of ‘hard- ware name_soft- ware purpose’ Ex) ERP_DB server_ DBMS, ERP_DB server_WAS, etc.
  • 332.
    332 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Software Type Enum Operating system WEB/WAS Middle ware DBMS Modeling tool Graphic tool Mail Virus Vaccine Others ⓞOther types Content Vender Enum CentOS Name of software manu- facturer (writing down manufacturer’s name, not supplier’s name) Ex) Oracle HP IBM Microsoft RedHat Oracle SUSE VMware Apache MySQL SAP PostgreSQL Others Name of SW Name Name of software named by its manufacturer Ex) Oracle DBMS 10g Introduction year Year YYYY Writing down the year when the SW is installed in Gregorian year Ex) 2009 Total cost Number SAR Total cost of the SW instal- lation Ex) 100,000 SAR Annual main- tenance cost Number SAR The cost of SW annual maintenance cost Ex) 100,000 SAR
  • 333.
    333 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Software License Policy Code User Software’s license manage- ment policy CPU Server Site Simultaneous Access Others Other license polices Content Relevant detailed contents in case license policy is others Number of license Number Data Name Name Name of data ※ It is a ‘data entity’ which represents a data subject from the common data model that is used in the conceptual or logical data model. (See Appendix ) Description Contents Type Enum Structured UnStructured
  • 334.
    334 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Data Data Classification Enum Location, Pollution, Overseas Saudi, Traffic Information, Weather, Law, Licensing, Policy, Individual, Public Official, Resident, Umrah & Haj Visitor, Relationship between Indi- vidual & Organization, Organization, Political Service, National Service, Document, Patent, Library, Statistics, Book Categories, Natural Resources, Movable Asset, Human Resources, Real estate, Budget, Accounting, Tangible Assets, Intangible Assets
  • 335.
    335 National Overall ReferenceArchitecture (NORA) – Handbook Component Property Item Domain Domain Restric- tion Explanation Data Centre Name Name Name of data ※ It is a ‘data entity’ which represents a data subject from the common data model that is used in the conceptual or logical data model. (See Appendix) Classification Enum Tier 1 Tier 2 Tier 3 Tier 4 Location Name Table ‎14-26: NEA Meta-Classes Component Property Item Domain Domain Restriction Explanation Business service Agency Name Name Name of business service Name Business service description Content Service Number Text Service Output Name Table ‎14-27: NEA business service Meta-Class
  • 336.
    336 National Overall ReferenceArchitecture (NORA) – Handbook Annex D: e-Government Transformation Plan D1. Mandates of A Government Entity Every government agency in the KSA has specific mandates to fulfill for instance the e- Government program of Yesser was founded since the government of KSA attaches great importance to transformation to e-Government, due to the enormous benefits of e-Gov- ernment concepts to the national economy. Royal Decree (133) dated 21/05/1424 assigned responsibility towards management, planning and development of the CIT sector, including launching e-Government, to Ministry of Communication and Information Technology (MCIT). Royal Decree (7/B/33181) dated 10/07/1424 H referred to MCIT the responsibility of establishing a plan to deliver e-Government services and procurement of necessary resources. Which resulted in the formulation of Yesser as an entity with mandates that it needs to deliver on. Based on this an entity would establish their vision, mission goals and objectives. D2. Strategic e-Government Transformation in an Agency “Strategic Management is trying to understand where you will fit in tomorrow’s world and de- ciding where you want to be and – getting there” :- Jack Welch The business strategy tries to answer 3 to 4 fundamental questions: • Whom to serve? - WHO • What to offer?- WHAT • How to serve? - HOW • Who should Serve? – BY WHOM
  • 337.
    337 National Overall ReferenceArchitecture (NORA) – Handbook The WHO and WHAT are part of business strategy and is dictated by the government agency mandates. HOW and by WHOM is addressed by means of strategic management. The business Strategy and strategic management are guided by Vision, Mission and Objectives of the gov- ernment agency and the National Strategy and Saudi e-Government action plans. So it is expected that an agency has a business strategy, captured by tools like balance score card, strategic management (and implementation) captured by tools like value chain or 7s framework. In organizations that have a sizable and mature IT division would develop their own IT strategy in line with the Business Strategy of the agency. The diagram below describes the various components of strategy management in an orga- nization.
  • 338.
    338 National Overall ReferenceArchitecture (NORA) – Handbook Agency Mandates MissionVision Objectives Business Model Today Business Model Tomorrow Business Strategy IT Strategy National Strategy & e- Government Action Plan BalanceScoreCardValueChain Figure ‎14-4: Components of Strategic Management in government agency D3. Overview of e-Government Transformation Plan The e-Government Transformation Plan is a roadmap for the agency to transform from the cur- rent state to an organizationally optimized and seamlessly integrated business functions and pro- cesses supported by an efficient ICT capability using Enterprise Architecture Methodology. The ultimate objective of the plan is to help the government agencies become more citizen-centered, service focused, efficient, process driven and result oriented. The plan mainly focuses on improv- ing government processes, connecting to citizens (through e-Services) and building standard inter- actions/integrations within and across the agencies.
  • 339.
    339 National Overall ReferenceArchitecture (NORA) – Handbook D4 How to use NORA for developing e-GovernmentTransformation Plan The organization is required to map its current and future architecture states in relation to the business and IT perspectives and subsequently prepare an architecture roadmap and imple- mentation governance that closes the gap between the two states - in other words, a blueprint of the organization’s ICT-enabled business. By utilizing NORA the agency produces the following deliverables: • Current Architecture – By completing stage 6 of NORA ( Build Current Architecture) • Target Architecture – By completing stage 7 of NORA ( Build Target Architecture) • Analysis that identifies the shortfalls of the current state in terms of its ability to support the objectives and strategies of the business, with respect to future state ( Part of Stage 6 and Stage 7 of NORA) • Transformation Plan (i.e. e-Government Strategic Transformation Plan) that defines the initiatives required to migrate from the current state into the future state. This is delivered as part of stage 8 of NORA.
  • 340.
    340 National Overall ReferenceArchitecture (NORA) – Handbook Agency Mandates MissionVision Objectives Business Model Today Business Model Tomorrow Business Strategy IT Strategy National Strategy & e- Government Action Plan Transformation Plan BalanceScoreCardValueChain Figure ‎14-5: Linking strategy and e-Government transformation The activities that need to be performed in carrying out this exercise is not exactly IT driven, it is linked directly to government entity mandates, National Strategy and Action Plans, business strategy and strategy management of the government entity. This also implies that the ade- quate involvement of not only executives of the agency but also the strategic and operational stakeholders are needed as well. Figure 14.5 illustrates the linkage of e-Transformation plan with components of strategy within the agency.
  • 341.
    341 National Overall ReferenceArchitecture (NORA) – Handbook D5. Relevant Artifacts for e-Government Transformation The agency e-Government Transformation plan comprises artifacts that represent: • Current State Enterprise Architecture • Artifacts related to Current Business Architecture • Artifacts related to Current Application Architecture • Artifacts related to Current Data Architecture • Artifacts related to Current Technology Architecture • Future State Enterprise Architecture • Artifacts related to Future Business Architecture • Artifacts related to Future Application Architecture • Artifacts related to Future Data Architecture • Artifacts related to Future Technology Architecture • Analysis that identifies the shortfalls of the current state in terms of its ability to support the objectives and strategies of the business, with respect to future state. • Artifacts that lists new ideas, gaps and opportunities for improvement in Business, Application, Data and Technology Domains • Transformation Plan (i.e. e-Government Strategic e-Transformation Plan) that defines the initiatives required to migrate from the current state into the future state. • Artifact that Represents e-Government Transformation Plan, which comprise of logi- cally grouped projects linked to the above list, their priorities and their respective timelines.
  • 342.
    342 National Overall ReferenceArchitecture (NORA) – Handbook Business Model Today Business Model Tomorrow Transformation Plan Business Applications Data Technology Business Applications Data Technology NORA EAPractice Figure ‎146: Relevant artifacts for e-Government Transformation Plan The e-Government Transformation Plan comprise of a set of NORA Artifacts and NORA Work Products, artifacts are the end deliverables from a NORA stage, whereas work products are the interim documentation or data collected or reports made while creating those deliverables. The below table shows the exhaustive list of the artifacts part of the e-Government Transforma- tion Plan.
  • 343.
    343 National Overall ReferenceArchitecture (NORA) – Handbook NORA Stage NORA Artifacts NORA Work Products Develop EA Strategy, Develop EA Project Plan and Analyze Current State. EA Strategy Agency’s Vision, Mission, Objectives and Initiatives. SWOT Analysis Agencies IT Project List Current IT Landscape Develop EA Framework Agencies EA Mission, Vision, Objectives Agencies Architecture Principle Agency PRM, BRM, ARM, DRM, TRM wherever applicable Build Current Architecture and Target Architecture Organization Chart Business Function Business Process Service Catalogue Build Current Architecture and Target Architecture Application Overview Application Catalogue Application Function Application Relationship Build Current Architecture and Target Architecture Data model Overview Dataflow Diagram Data Logical Diagram Data Dictionary Database Portfolio Catalogue Build Current Architecture and Target Architecture Infrastructure Overview Infrastructure Description HW and SW Catalogue Build Current Architecture ,Target Architecture and Build Transition Plan Current Architecture Analysis List of Improvement Ideas or Gap AnalysisDirections for Target Architecture Target BA, AA, DA, TA Prioritized Project List Project Roadmap Transition Plan Table ‎14-28: List of artifacts for e-Government Transformation Plan
  • 344.
    344 National Overall ReferenceArchitecture (NORA) – Handbook D6. Exhaustive list of e-Government Transformation artifacts The exhaustive list of artifacts that are of use in building the e-Government Transformation plan is listed below, although all of them are not mandatory but it does help in constructing a better picture and hence to plan better. 1. Vision 2. Message/Mission 3. Strategic Goals 4. Risks &Challenges 5. Stakeholders 6. Values & Principles 7. Conceptual Model 8. Organizational Structure 9. Services 10. Processes 11. Business Requirements 12. Business Gaps 13. Listing Applications 14. Listing Applications Modules 15. Relations between Applications 16. Applications Requirements 17. Applications Gaps 18. Data Entities 19. Relationships between Data Entities & Applications 20. Relationships between Data Entities and Business Structure 21. Methods of Data Management and its security 22. Data Requirements 23. Data Gaps 24. Listing Technology Components. 25. Technology References Definition. 26. References of Technology security. 27. Relationships between Technology Components &Information Systems. 28. Technology Infrastructure Requirements 29. Counting Technology Gaps 30. Gaps Listing 31. Definition of initiatives and future projects 32. Roadmap for Transformation
  • 345.
    345 National Overall ReferenceArchitecture (NORA) – Handbook Annex E: NEA EA maturity model The EA Core team can evaluate and measure its EA maturity. The team can obtain the EA Matu- rity measurement from NEA, Yesser. This maturity measurement should be done on an annual basis. From the maturity index, the EA Core team can reflect and re-plan how they can improve their EA execution. Since the government agency will be assessed on its EA, the Core team has to understand the National EA Maturity Model that has 5 maturity levels. 1. Initial or Informal 2. Under Development 3. Defined 4. Managed 5. Optimizing. It also has 5 components or areas of measurement - EA Process, EA Development, Business Linkage, Senior Management Involvement and EA Communication. Figure 14-7 illustrates the NEA EA Maturity Model while Table 14-29 describes the details of each level. Figure ‎14-7: NEA EA maturity model
  • 346.
    346 National Overall ReferenceArchitecture (NORA) – Handbook Maturity Component / Maturity Level Measurement Description EA Process Is there an established EA process? 1 Ad-hoc EA processes exist 2 Basic EA processes are defined 3 The EA processes are well defined and all of them are documented 4 The EA processes are part of the culture and are linked to business & IT processes 5 The EA processes are optimized and continuously improved based on quality metrics EA Development To what extent are the EA documents and deliverables provided by EA (team/division/office)? 1 Ad-hoc EA documentation and standards exist 2 Basic EA documentation such as ‘Organization structure diagram’, ‘Appli- cation architecture diagram’, ‘Data entities diagram’ and more than one of ‘Reference models’ exist 3 All of EA documentation such as Current architecture, Target architec- ture, Gap analysis and Migration plan, ‘5 Reference models(PRM, BRM, ARM, DRM, TRM)’, and ‘Meta model’ exist 4 Updated EA documentation exists to reflect the major IT and business changes 5 EA documentation is continuously or periodically updated to reflect all IT and business changes Business Linkage To what extent is the EA linked to business strategies or drivers? 1 Minimal or implicit linkage to business strategies or business drivers 2 Explicit linkage to business strategies or drivers. , EA is involved in the initiation of any new business initiatives 3 EA is integrated with Business processes management. Explicit linkage to business drivers and information requirements
  • 347.
    347 National Overall ReferenceArchitecture (NORA) – Handbook 4 Business processes management are adjusted based on the feedback re- ceived and lessons learned from updated EA. Periodic re-examination of business drivers 5 EA metrics are used to optimize and drive business linkages. Business involved in the continuous process improvements of EA Senior Management (CEO/CIO/Director) Involvement To what extent are the senior management involved in the establishment and ongoing development of the EA? 1 EA Core team is established but Limited management team awareness or involvement in the EA process 2 Occasional / selective senior management (IT Director) involvement with the EA Core team and in EA Process with various degrees of commitment 3 Senior-management team (IT Director) aware of and supportive of the EA process 4 Senior-management team (CIO) directly involved in the EA review process 5 Senior-management team (CEO) directly involved in the optimization of the EA development process and governance EA Communication To what extent are the decisions of EA practice documented? 1 Using ad-hoc tools for EA documentation, for example Visio diagrams, Word documents and Excel sheets 2 The operating unit’s EA documentation is available on webpage based on ad-hoc tool information, this can be internal webpage or external 3 The operating unit EA webpages are updated periodically and are used to document EA deliverables 4 EA documents updated regularly on EA web page and EA tools are used to support maintaining and managing EA documentation 5 EA documents frequently reviewed for latest EA developments / stan- dards with awareness session to IT staff on EA content Table ‎14-29: EA maturity components & levels
  • 348.
    348 National Overall ReferenceArchitecture (NORA) – Handbook Annex F: Business Service Attributes Every government entity is mandated to provide information regarding their business services into the Marsad system. The table below lists all the attributes the agency need to provide. S/ No Attributes in Arabic Attributes In English Value 1 ‫الخدمة‬ ‫رقم‬ service number 2 ‫عربي‬ - ‫الخدمة‬ ‫اسم‬ Service Name-Arabic 3 ‫انجليزي‬ - ‫الخدمة‬ ‫اسم‬ Service Name-English 4 ‫للخدمة‬ ‫المقدمة‬ ‫اإلدارة‬ Service provider department 5 ‫الخدمة‬ ‫نوع‬ service type 6 ‫الخدمة؟‬ ‫تصنيف‬ Service classification 7 ‫المستفيد؟‬ ‫حسب‬ ‫الخدمة‬ ‫نوع‬ service type by the beneficiary 8 ‫الجغرافية‬ ‫التغطية‬ Geographic coverage 9 ‫الخدمة‬ ‫على‬ ‫الحصول‬ ‫رسوم‬ Service fee 10 ‫الوطنية‬ ‫الميزانية‬ ‫من‬ ‫الخدمة‬ ‫تمويل‬ ‫تم‬ ‫هل‬ ‫الحكومية؟‬ ‫اإللكترونية‬ ‫للتعامالت‬ Is the service has been funded by the national e- Government budget? 11 ‫على‬ ‫للحصول‬ ‫باأليام‬ ‫المستغرق‬ ‫الوقت‬ ‫الراهن‬ ‫الوضع‬ ‫(خالل‬ ‫)الخدمة‬ The time consumed(By days) to provide the ser- vice (through the status quo) 12 ‫على‬ ‫للحصول‬ ‫باأليام‬ ‫المستغرق‬ ‫الوقت‬ ‫المستقبلي‬ ‫الوضع‬ ‫(خالل‬ ‫)الخدمة‬ The time consumed(By days) to provide the ser- vice (during future status) 13 ‫للجهة‬ ‫تابعة‬ ‫الخدمة‬ ‫لتقديم‬ ‫مواقع‬ ‫هناك‬ ‫هل‬ ‫الرسمي‬ ‫الدوام‬ ‫وقت‬ ‫خارج‬ ‫تعمل‬ Are there Service channels outside official work- ing time? 14 ‫لدى‬ ‫بيانات‬ ‫أو‬ ‫خدمات‬ ‫على‬ ‫الخدمة‬ ‫تعتمد‬ ‫هل‬ ‫أخرى؟؟‬ ‫حكومية‬ ‫جهات‬ Does the service rely on other government agen- cies services and data ? 15 ‫جهات‬ ‫لدى‬ ‫خدمات‬ ‫الخدمة‬ ‫هذه‬ ‫تدعم‬ ‫هل‬ ‫أخرى؟؟‬ ‫حكومية‬ Does the service support other government agen- cies services? 16 ‫الرقمي‬ ‫التصديق‬ ‫خاصية‬ ‫تفعيل‬ ‫تم‬ ‫هل‬ ‫لمستفيدي‬ ‫الرقمي‬ ‫التصديق‬ ‫شهادة‬ ‫وإصدار‬ ‫الخدمة؟؟‬ ‫هذه‬ ‫ومستخدمي‬ Is digital certification feature activated? Is issuing digital certification for the beneficiaries and users ac- tivated? 17 ‫الخدمة؟‬ ‫نضج‬ ‫مستوى‬ Service maturity level
  • 349.
    349 National Overall ReferenceArchitecture (NORA) – Handbook 18 ‫اليه‬ ‫الوصول‬ ‫يمكن‬ ‫الخدمة‬ ‫لنضج‬ ‫مستوى‬ ‫أعلى‬ The highest service maturity level can be reached 19 ‫النضج؟‬ ‫في‬ ‫األعلى‬ ‫للمستوى‬ ‫الخدمة‬ ‫انتقال‬ ‫تاريخ‬ Date of service transmission to the next level of maturity 20 ‫الخدمة‬ ‫من‬ ‫المستهدفين‬ ‫عدد‬ The targeted beneficiaries number of service 21 ‫بشكلها‬ ‫سنويًا‬ ‫الخدمة‬ ‫من‬ ‫المستفيدين‬ ‫عدد‬ ‫االلكتروني‬ The number of service beneficiaries (electronic form) annually 22 ‫السنة‬ ‫خالل‬ ‫االلكترونية‬ ‫العمليات‬ ‫عدد‬ The number of electronic transactions annually 23 ‫الواحد‬ ‫للمستفيد‬ ‫الخدمة‬ ‫استخدام‬ ‫تكرار‬ Frequent use of service by a beneficiary. 24 ‫في‬ ‫الخدمة‬ ‫وحالة‬ ‫الخدمة‬ ‫أتمتته‬ ‫قابلية‬ ‫الحالي‬ ‫وضعها‬ Service automation availability and current state 25 ‫متاحة؟‬ ‫الخدمة‬ ‫وإجراءات‬ ‫متطلبات‬ ‫هل‬ Are the requirements and procedures of service available? 26 ‫إجراءاتها؟‬ ‫توثيق‬ ‫تم‬ ‫هل‬ Are the service procedures documented? 27 ‫الخدمة‬ ‫عمل‬ ‫مسار‬ ‫رسم‬ ‫تم‬ ‫هل‬ (workflow chart)‫؟‬ Is the service workflow chart designed ? 28 ‫هندستها‬ ‫إعادة‬ ‫أو‬ ‫إجراءاتها‬ ‫تحسين‬ ‫تم‬ ‫هل‬ ‫)؟؟‬BPR/BPI( Have the service procedures been improved or re-engineered (BPR / BPI)? 29 ‫موحدة؟‬ ‫الخدمة‬ ‫تقديم‬ ‫إجراءات‬ ‫هل‬ Are the procedures of providing the service unified? 30 ‫الخدمة‬ ‫تقديم‬ ‫قنوات‬ Service channels 31 ‫عربي‬ - ‫للخدمة‬ ‫المباشر‬ ‫االلكتروني‬ ‫الرابط‬ Service link in the official websites - Arabic 32 ‫انجليزي‬ - ‫للخدمة‬ ‫المباشر‬ ‫االلكتروني‬ ‫الرابط‬ Service link in the official websites-English 33 ‫اليوتيوب‬ ‫على‬ ‫الفيديو‬ ‫رابط‬ Video link on YouTube 34 ‫اآللي‬ ‫بالرد‬ ‫الخاص‬ ‫االتصال‬ ‫رقم‬ IVR call number 35 ‫اإلستخدام‬ ‫لطريقة‬ ‫رابط‬ Service usage link 36 ‫الخدمة‬ ‫استخدام‬ ‫دليل‬ Service usage guideline 37 ‫عربي‬ - ‫الخدمة‬ ‫وصف‬ Service Description - Arabic 38 ‫انجليزي‬ - ‫الخدمة‬ ‫وصف‬ Service Description - English 39 ‫الخدمة‬ ‫تنفيذ‬ ‫خطوات‬ Service implementation steps Table ‎14-30: Attributes of business service (Arabic & English)
  • 350.
    350 National Overall ReferenceArchitecture (NORA) – Handbook
  • 351.
    351 National Overall ReferenceArchitecture (NORA) – Handbook
