SlideShare a Scribd company logo

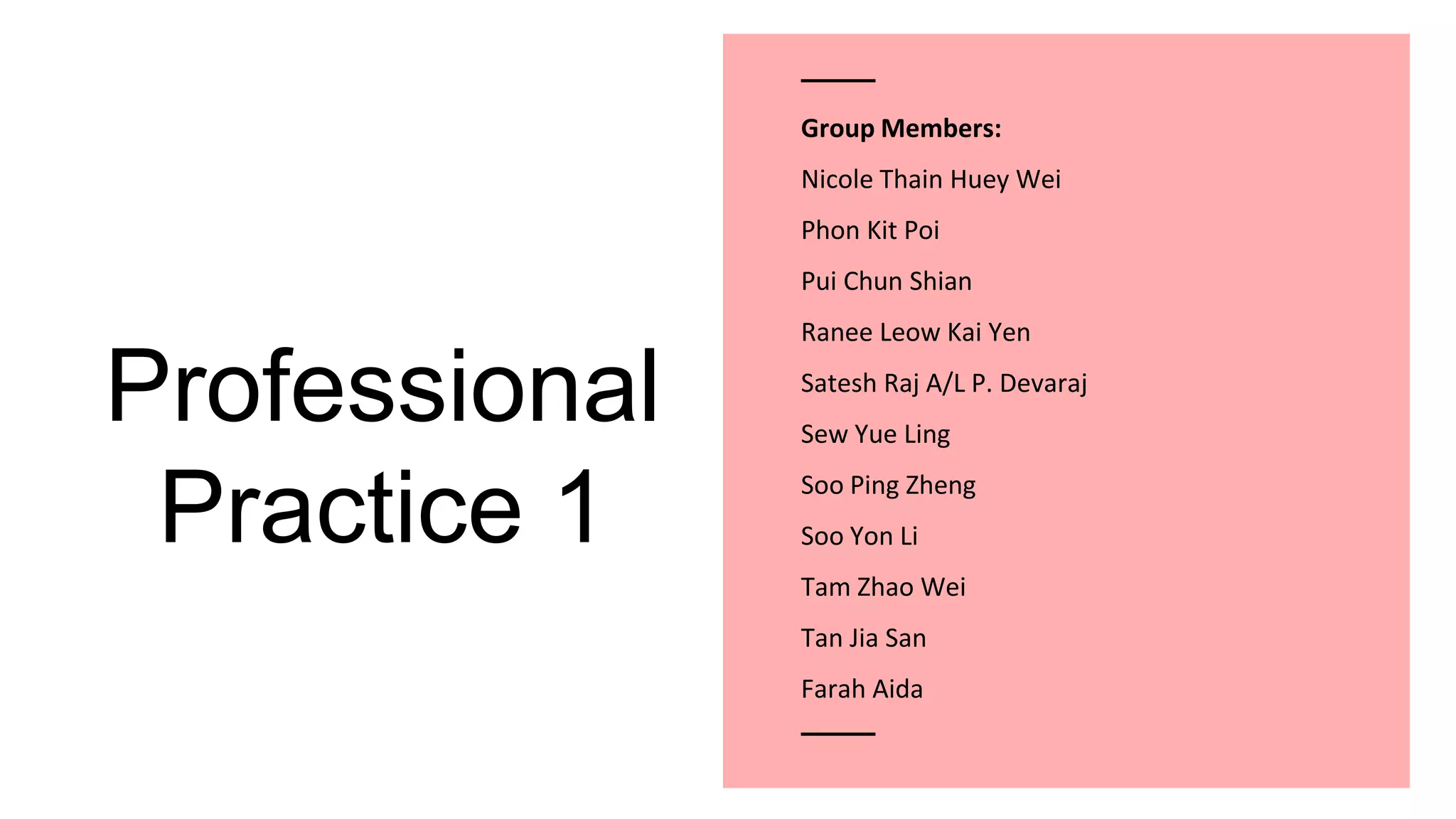

Professional
Practice 1
Group Members:
Nicole Thain Huey Wei
Phon Kit Poi
Pui Chun Shian
Ranee Leow Kai Yen
Satesh Raj A/L P. Devaraj
Sew Yue Ling
Soo Ping Zheng
Soo Yon Li
Tam Zhao Wei
Tan Jia San
Farah Aida
TRADITIONAL
PROCUREMENT

WHY TRADITIONAL PROCUREMENT ?
Completion on time (5 years)
Variation in design
Minimum variation in Contract Sum
Deal with minimum parties
Full control of design

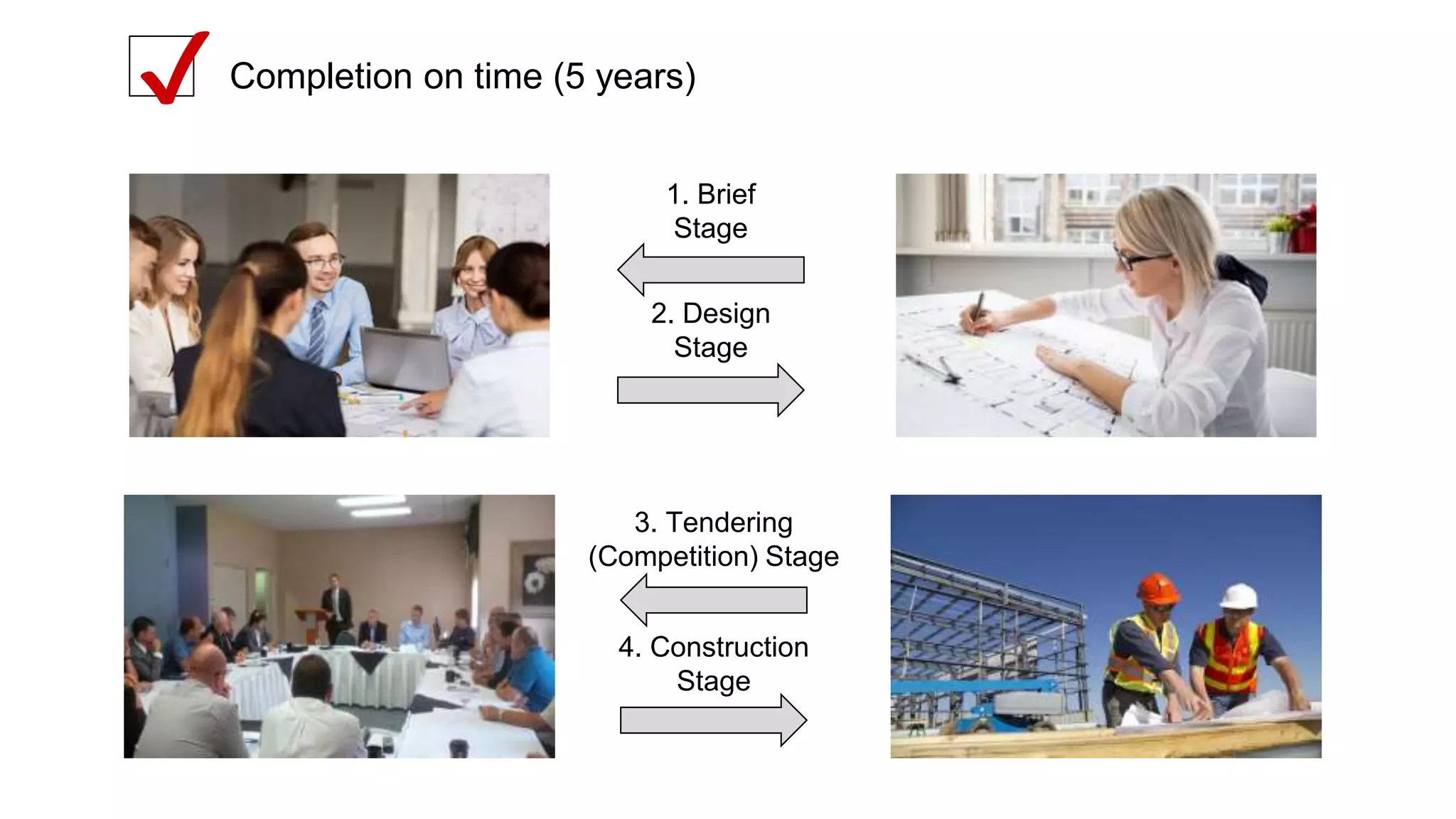

1. Brief
Stage
2. Design
Stage
3. Tendering
(Competition) Stage
4. Construction
Stage

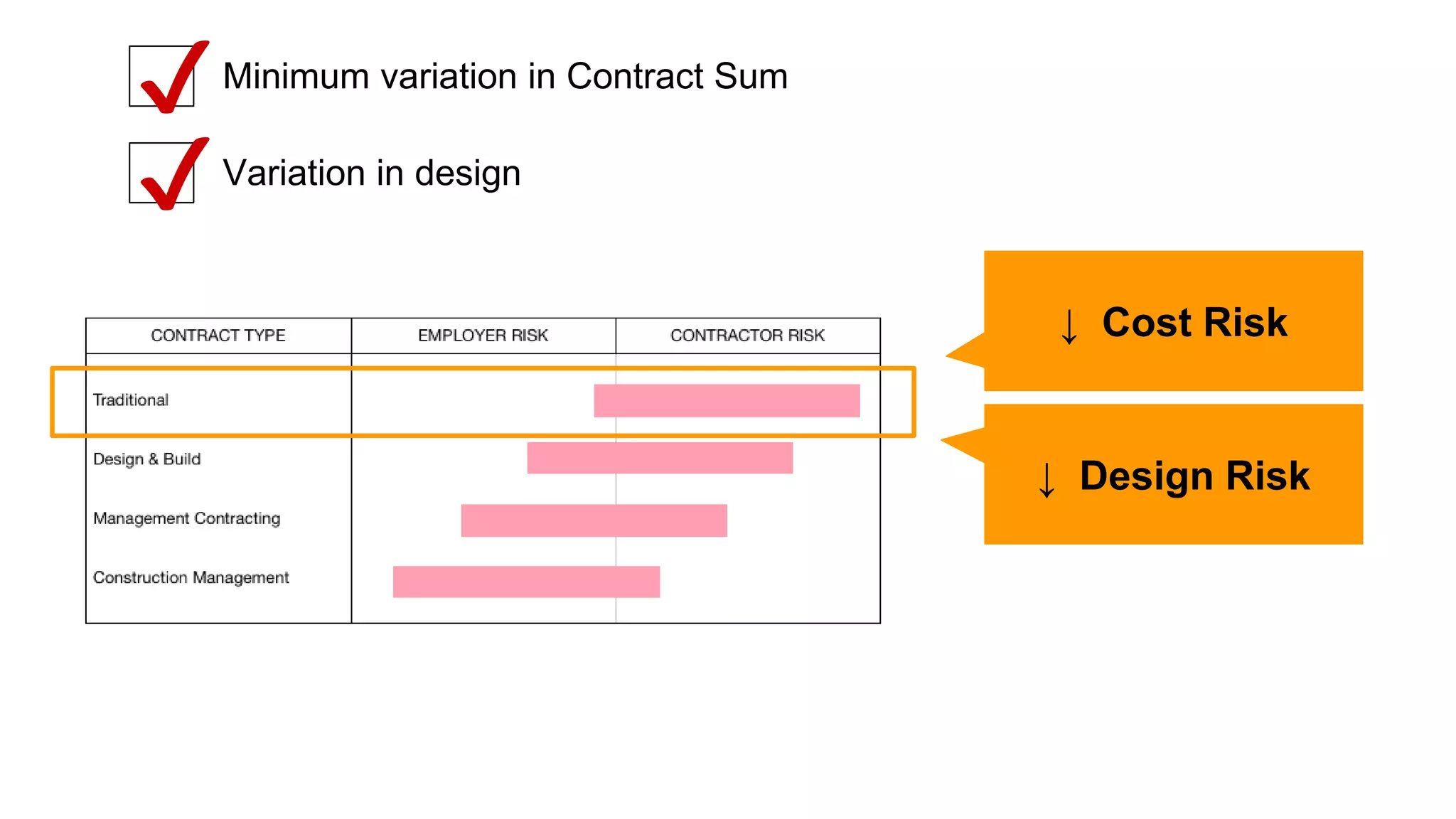

Completion on time (5 years)✔
Variation in design
Minimum variation in Contract Sum
✔
✔
↓ Cost Risk

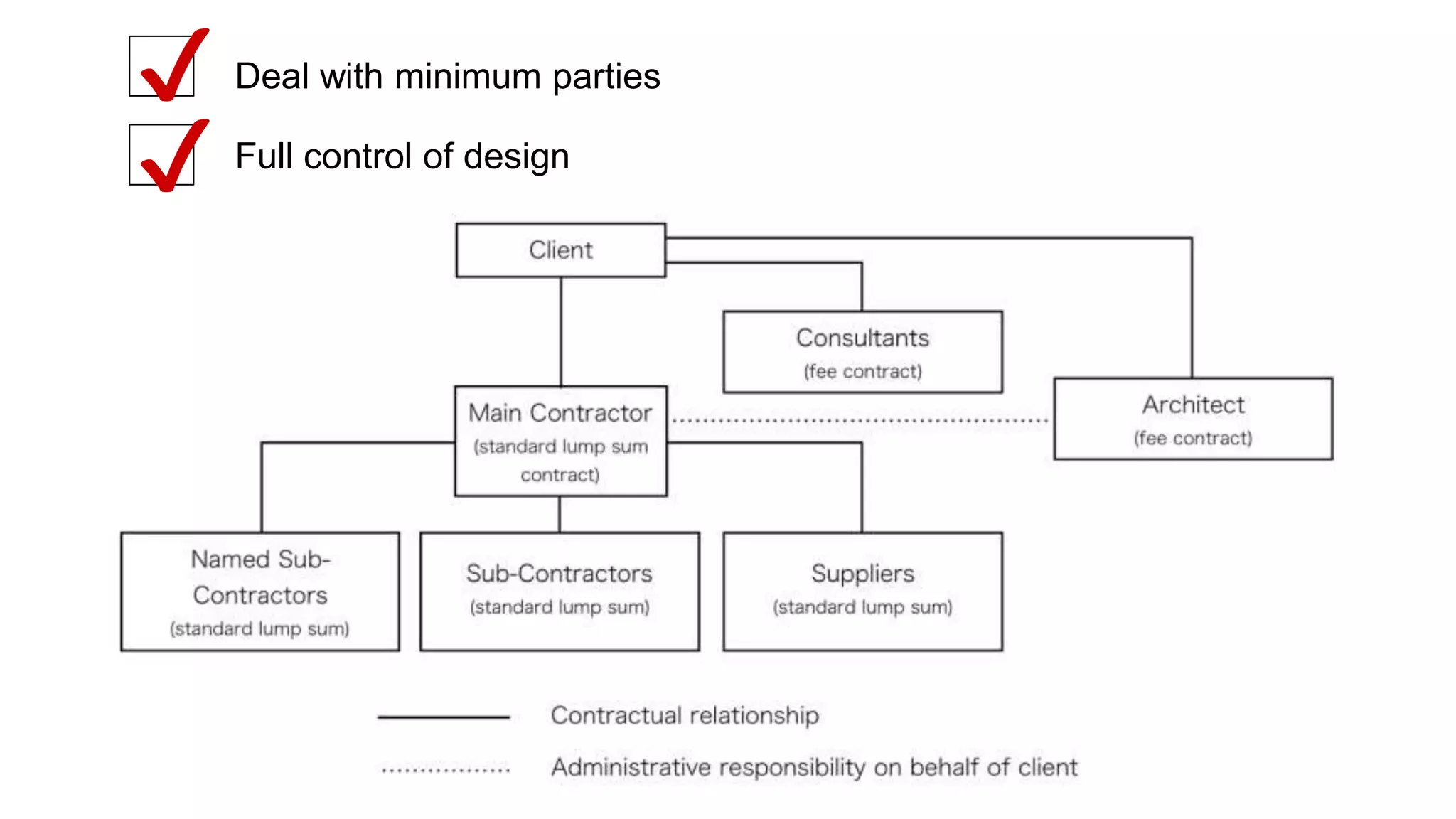

↓ Design Risk
Deal with minimum parties
Full control of design
✔
✔

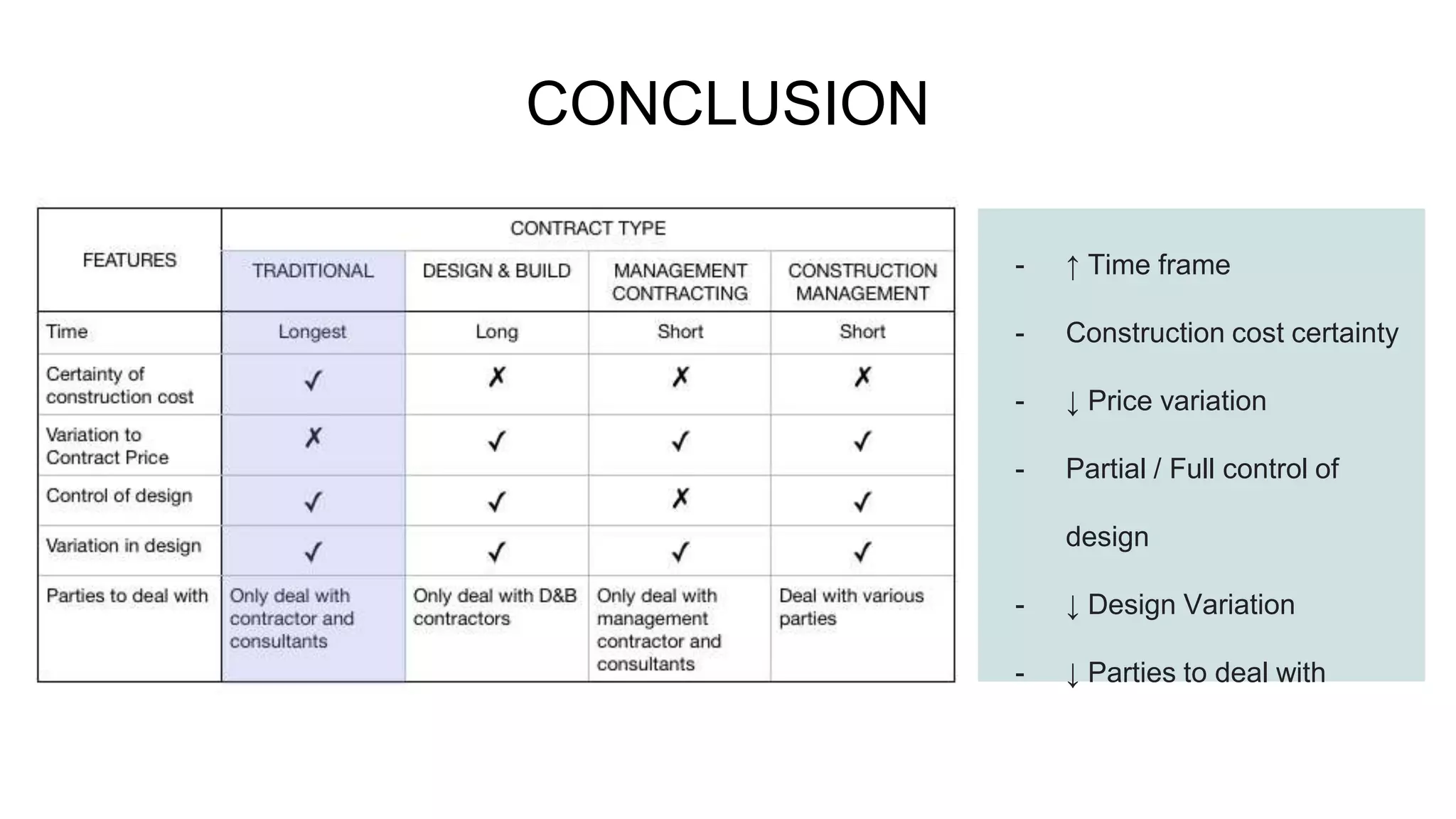

CONCLUSION
- ↑ Time frame
- Construction cost certainty
- ↓ Price variation
- Partial / Full control of
design
- ↓ Design Variation
- ↓ Parties to deal with
TWO STAGE SELECTIVE
TENDERING

WHY TWO STAGE SELECTIVE
TENDERING ?
Reasonably transparent
Eliminate non-performing contractors

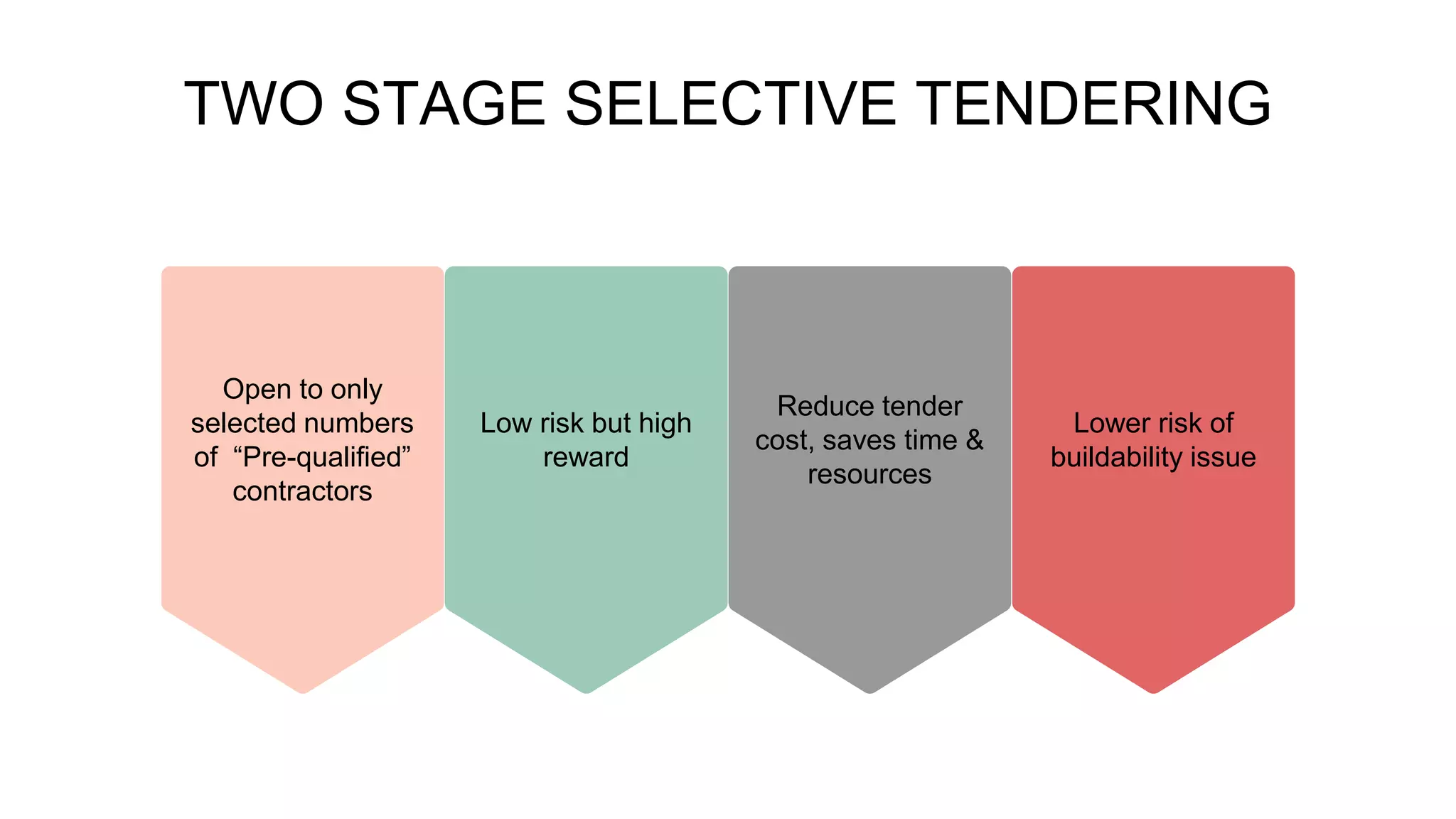

TWO STAGE SELECTIVE TENDERING
Open to only
selected numbers
of “Pre-qualified”
contractors
Reduce tender
cost, saves time &
resources
Low risk but high
reward
Lower risk of
buildability issue
Reasonably transparent
✔

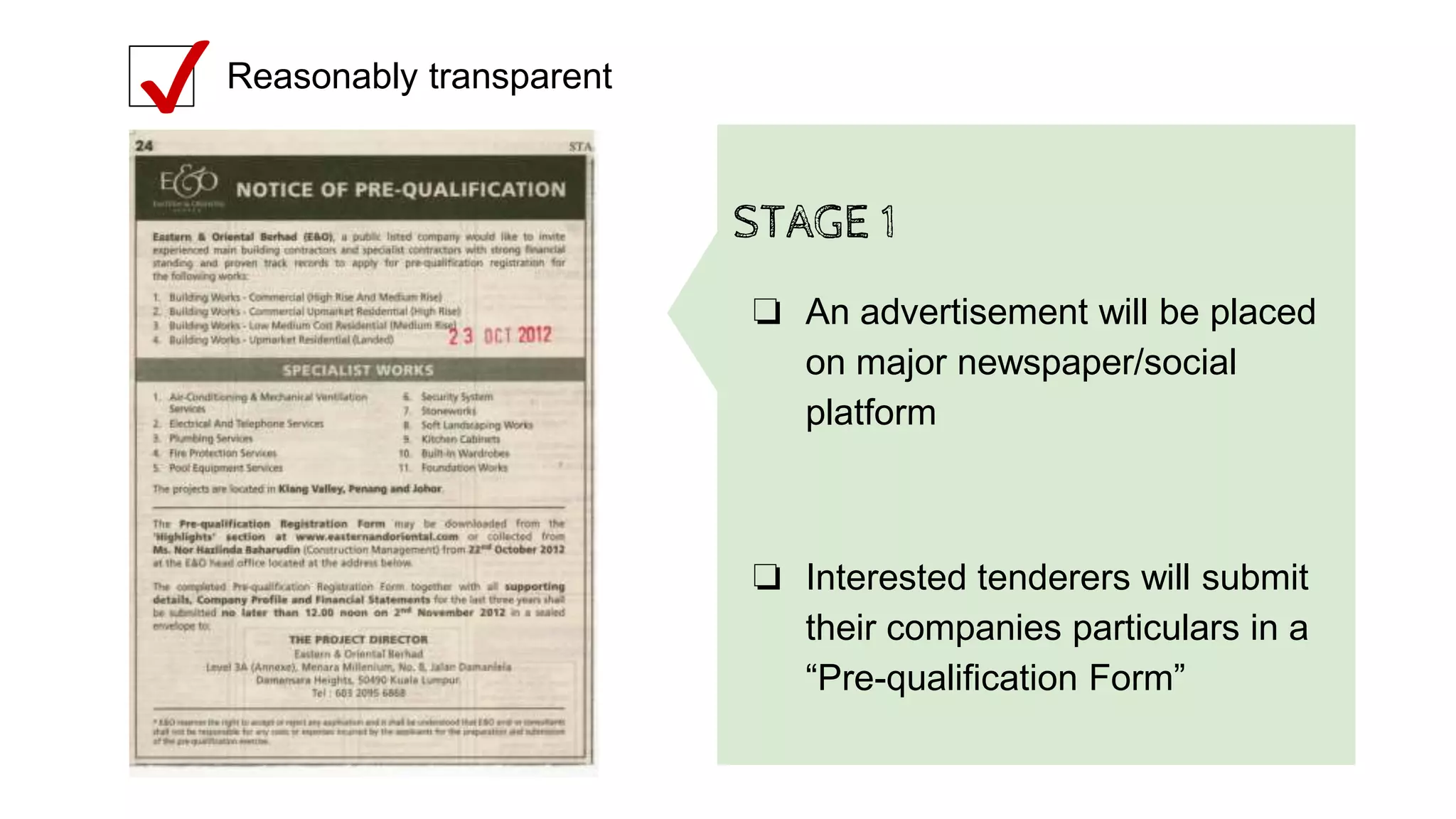

STAGE 1
❏ An advertisement will be placed
on major newspaper/social
platform
❏ Interested tenderers will submit
their companies particulars in a
“Pre-qualification Form”
Eliminate non-performing contractors
✔

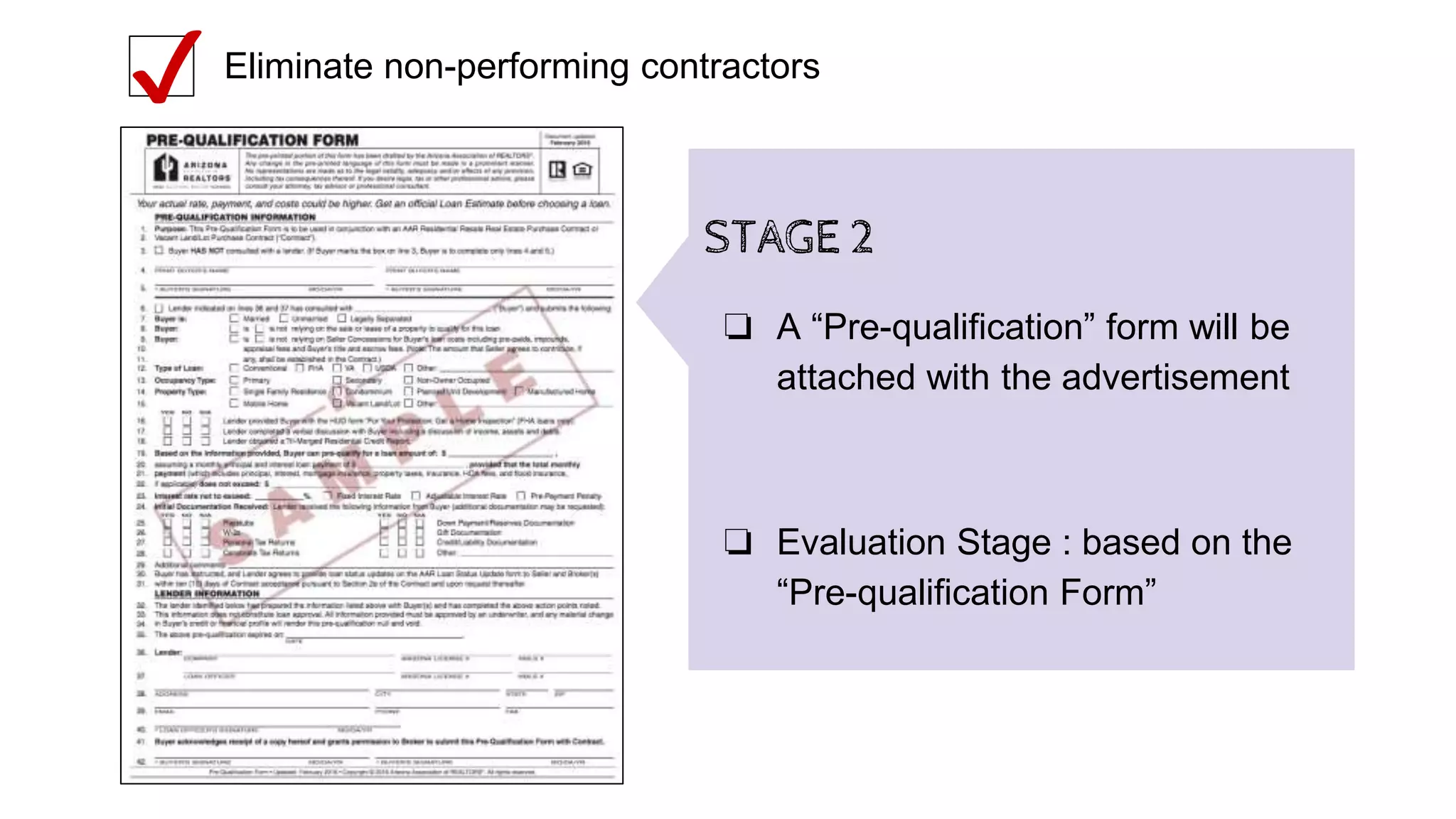

STAGE 2
❏ A “Pre-qualification” form will be
attached with the advertisement
❏ Evaluation Stage : based on the
“Pre-qualification Form”
TWO-STAGE SELECTIVE TENDERING

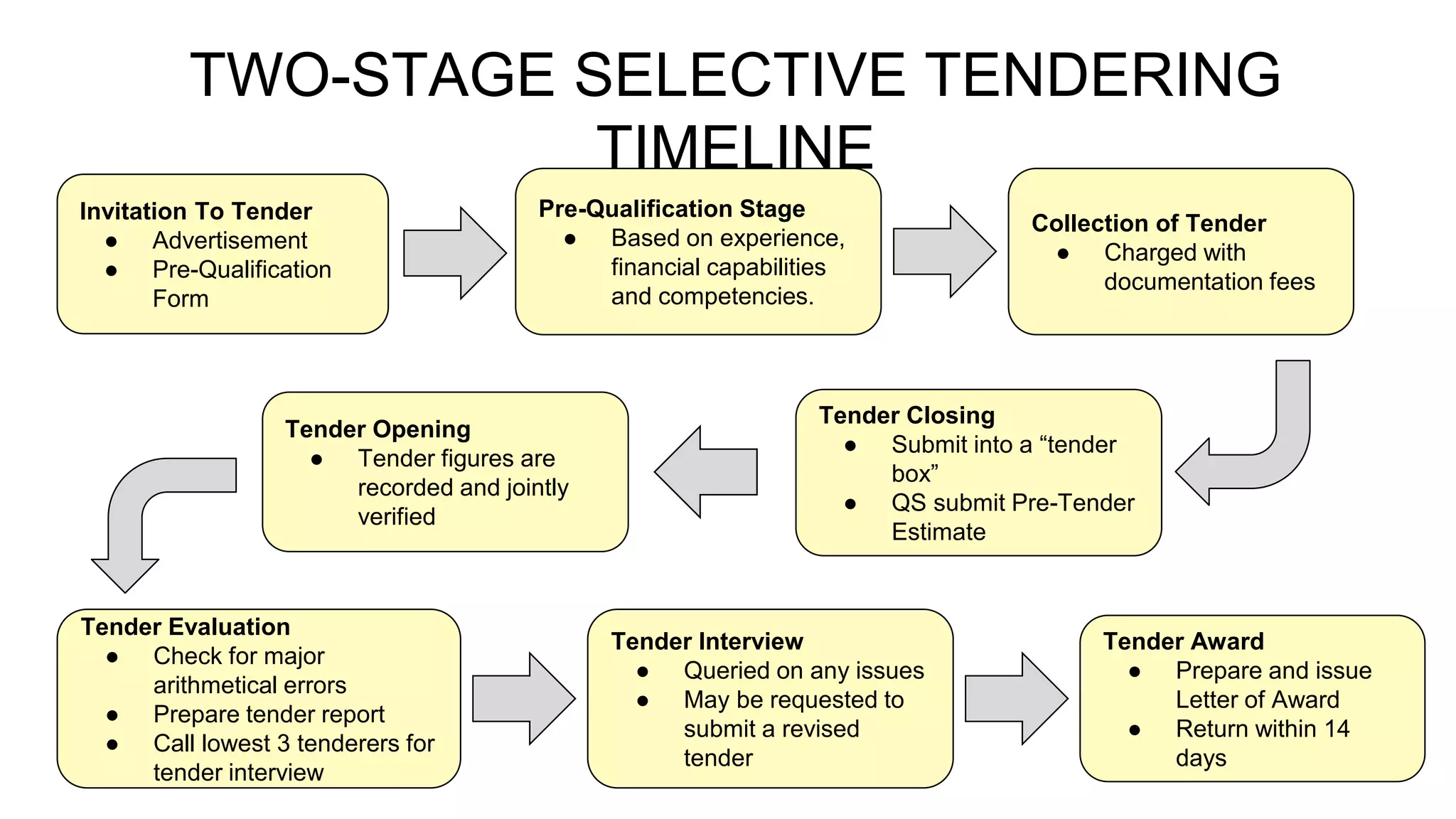

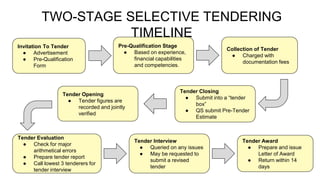

TIMELINE
Invitation To Tender
● Advertisement
● Pre-Qualification
Form
Pre-Qualification Stage
● Based on experience,
financial capabilities
and competencies.
Collection of Tender
● Charged with
documentation fees
Tender Closing
● Submit into a “tender
box”
● QS submit Pre-Tender
Estimate
Tender Opening
● Tender figures are
recorded and jointly
verified
Tender Evaluation
● Check for major
arithmetical errors
● Prepare tender report
● Call lowest 3 tenderers for
tender interview
Tender Interview
● Queried on any issues
● May be requested to
submit a revised
tender
Tender Award
● Prepare and issue
Letter of Award
● Return within 14
days
CONTRACT
ARRANGEMENT
LUMP SUM CONTRACT

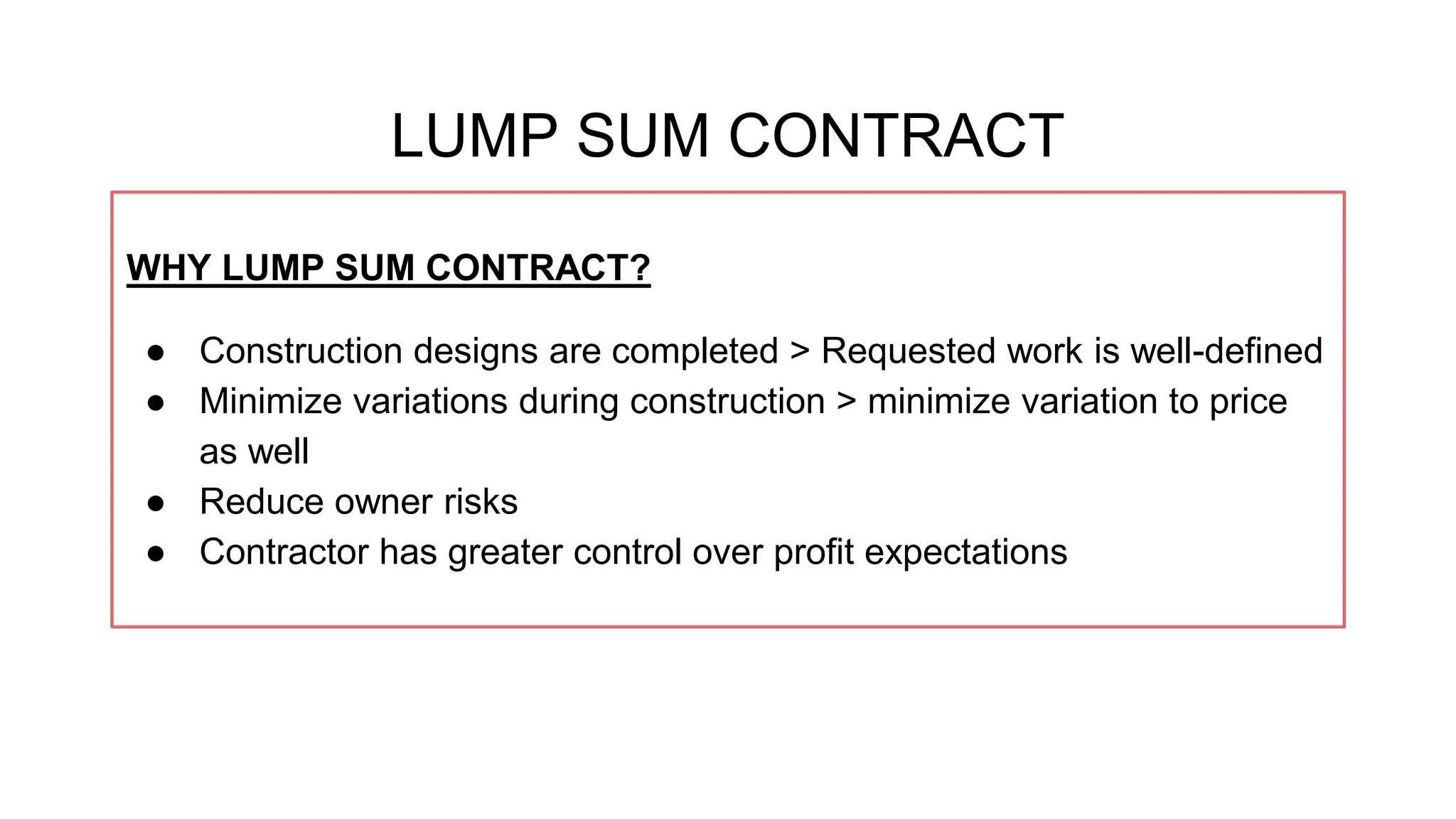

WHY LUMP SUM CONTRACT?
● Construction designs are completed > Requested work is well-defined
● Minimize variations during construction > minimize variation to price
as well
● Reduce owner risks
● Contractor has greater control over profit expectations

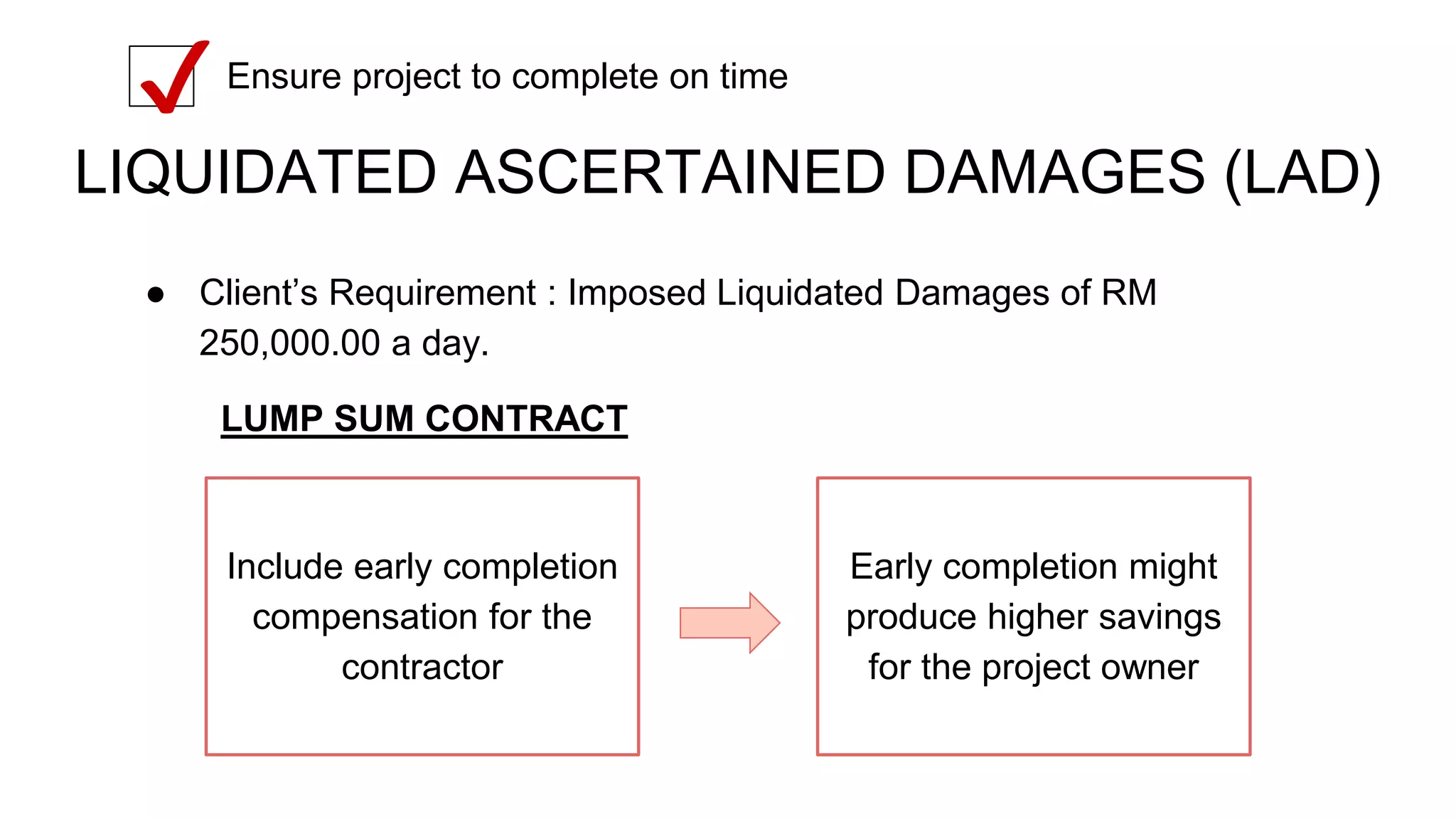

LIQUIDATED ASCERTAINED DAMAGES (LAD)
● Client’s Requirement : Imposed Liquidated Damages of RM
250,000.00 a day.
Ensure project to complete on time
✔
Include early completion
compensation for the
contractor
Early completion might
produce higher savings
for the project owner
LUMP SUM CONTRACT

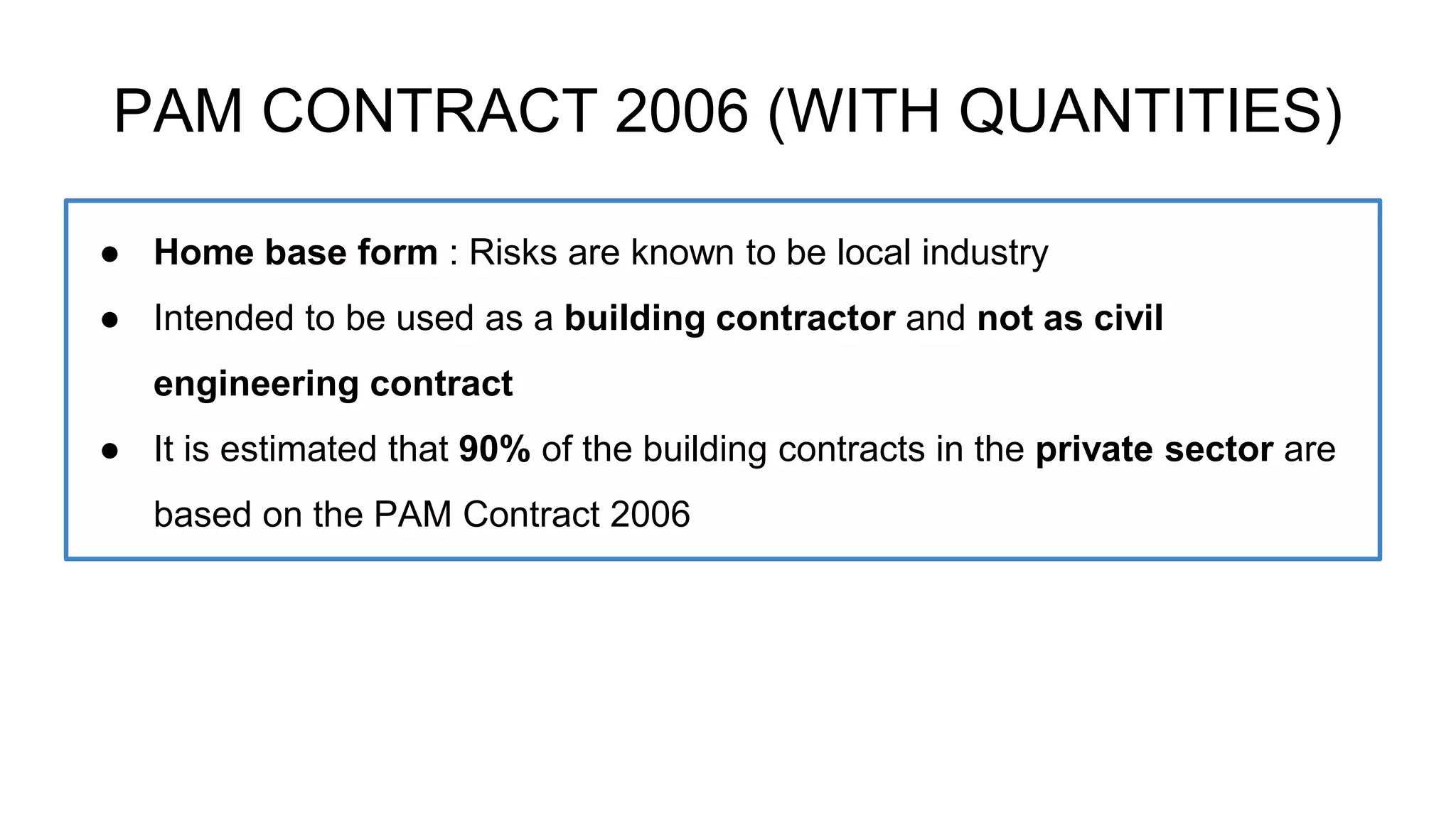

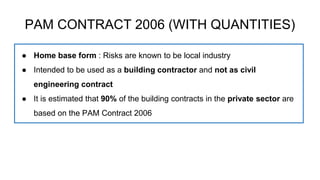

PAM CONTRACT 2006 (WITH QUANTITIES)
● Home base form : Risks are known to be local industry
● Intended to be used as a building contractor and not as civil
engineering contract
● It is estimated that 90% of the building contracts in the private sector are
based on the PAM Contract 2006

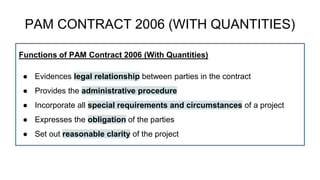

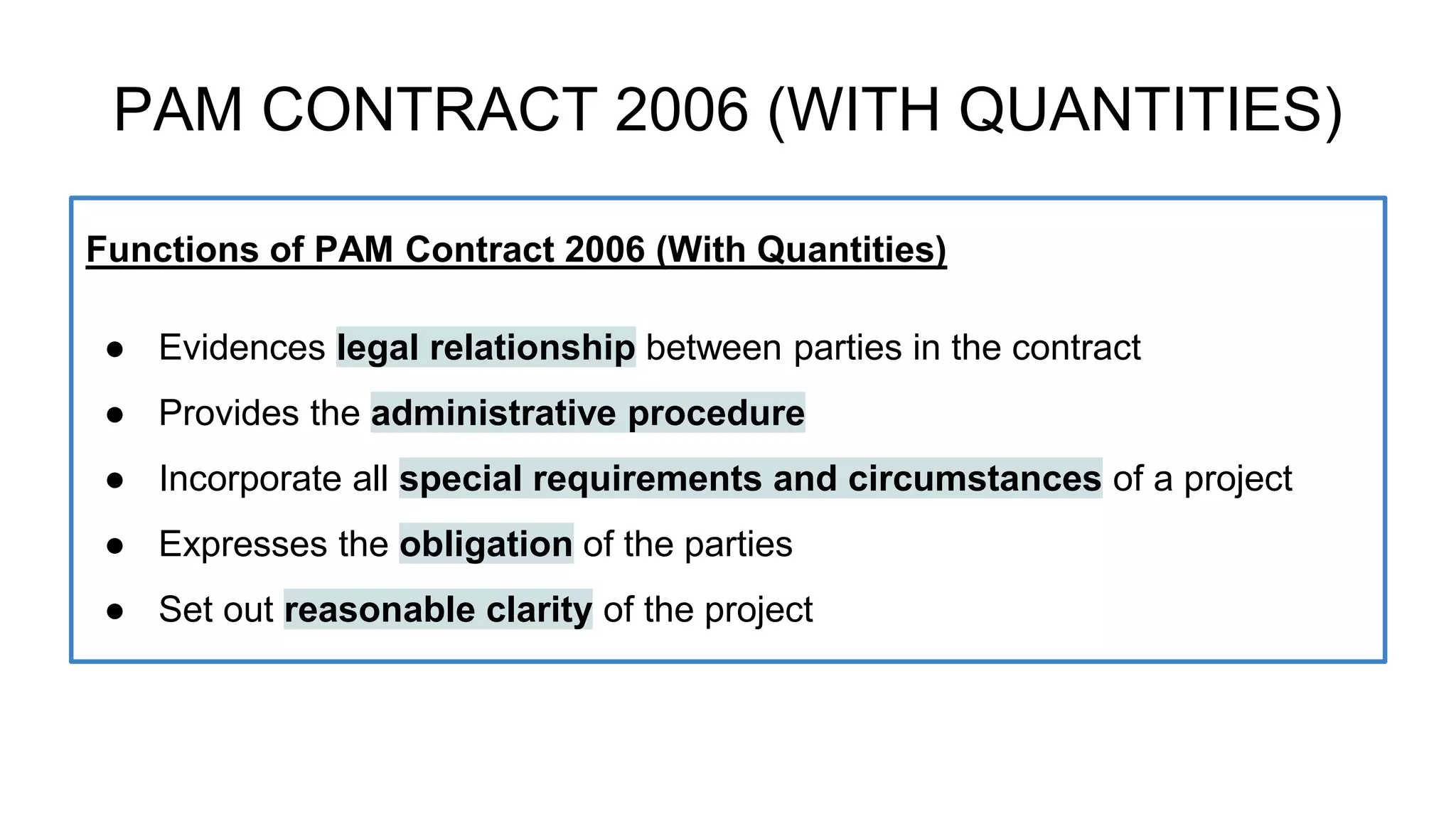

Functions of PAM Contract 2006 (With Quantities)
● Evidences legal relationship between parties in the contract
● Provides the administrative procedure
● Incorporate all special requirements and circumstances of a project
● Expresses the obligation of the parties
● Set out reasonable clarity of the project
PAM CONTRACT 2006 (WITH QUANTITIES)

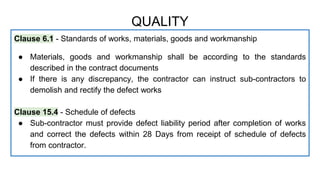

Clause 6.1 - Standards of works, materials, goods and workmanship
● Materials, goods and workmanship shall be according to the standards
described in the contract documents
● If there is any discrepancy, the contractor can instruct sub-contractors to
demolish and rectify the defect works
Clause 15.4 - Schedule of defects
● Sub-contractor must provide defect liability period after completion of works
and correct the defects within 28 Days from receipt of schedule of defects
from contractor.

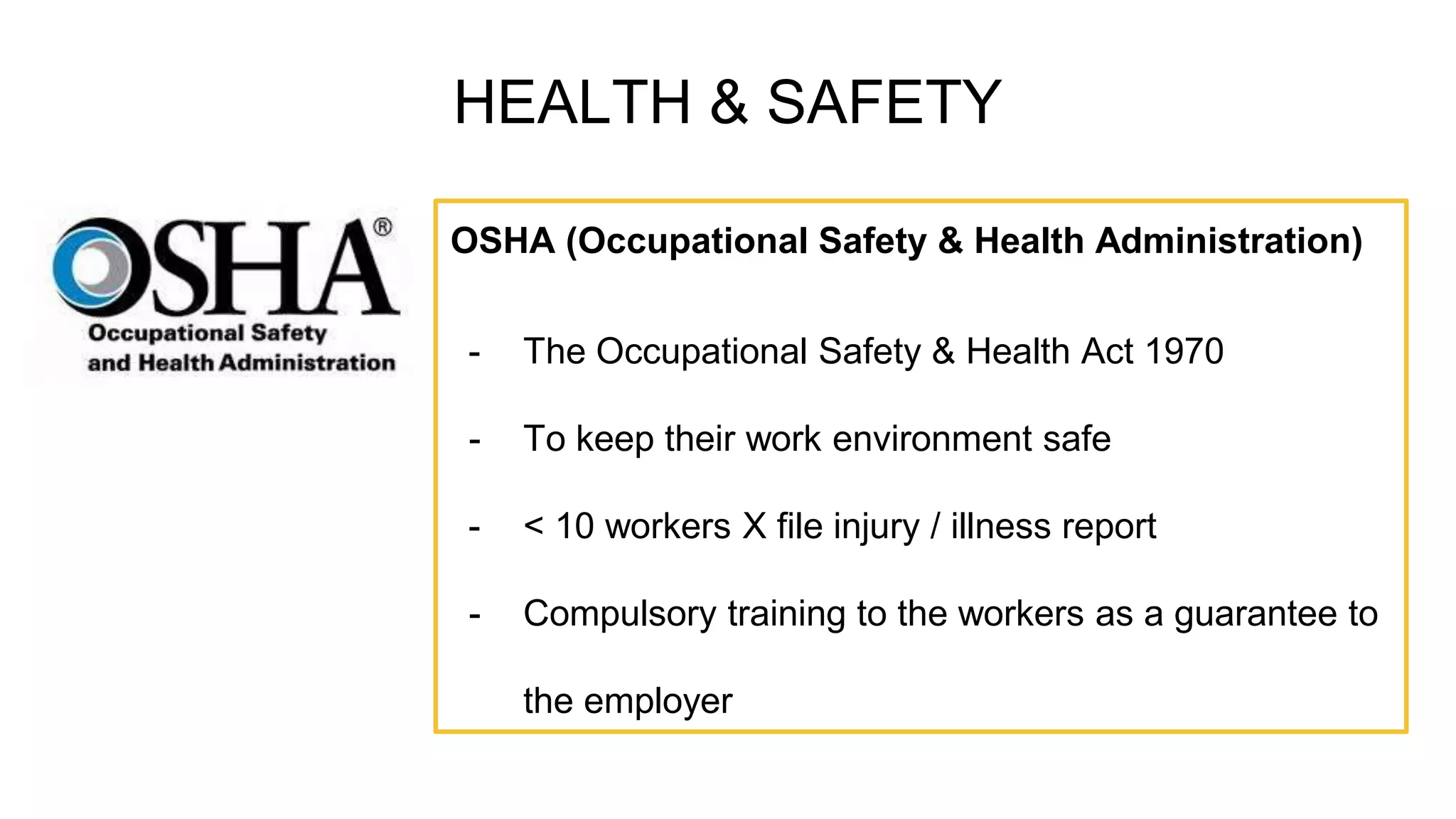

QUALITY
HEALTH & SAFETY
OSHA (Occupational Safety & Health Administration)
- The Occupational Safety & Health Act 1970
- To keep their work environment safe
- < 10 workers X file injury / illness report
- Compulsory training to the workers as a guarantee to
the employer
1. Appoint a Safety
Advisor
HOW TO ENHANCE HEALTH & SAFETY ?
Essential to give professional
advices.
OSHA Clause 8.1
- Training & Competency
2. Proposed Site
Management Plan
(SMP)
Compliance to Occupational Safety
and Health in Construction Industry
(Management)
- Ensure a safer working
environment
3. Allow Separate
Specification for
Health & Safety
The Health & Safety
Specification may include any
details regarding health and
safety matters
THANK YOU
