Microelectronics Technology

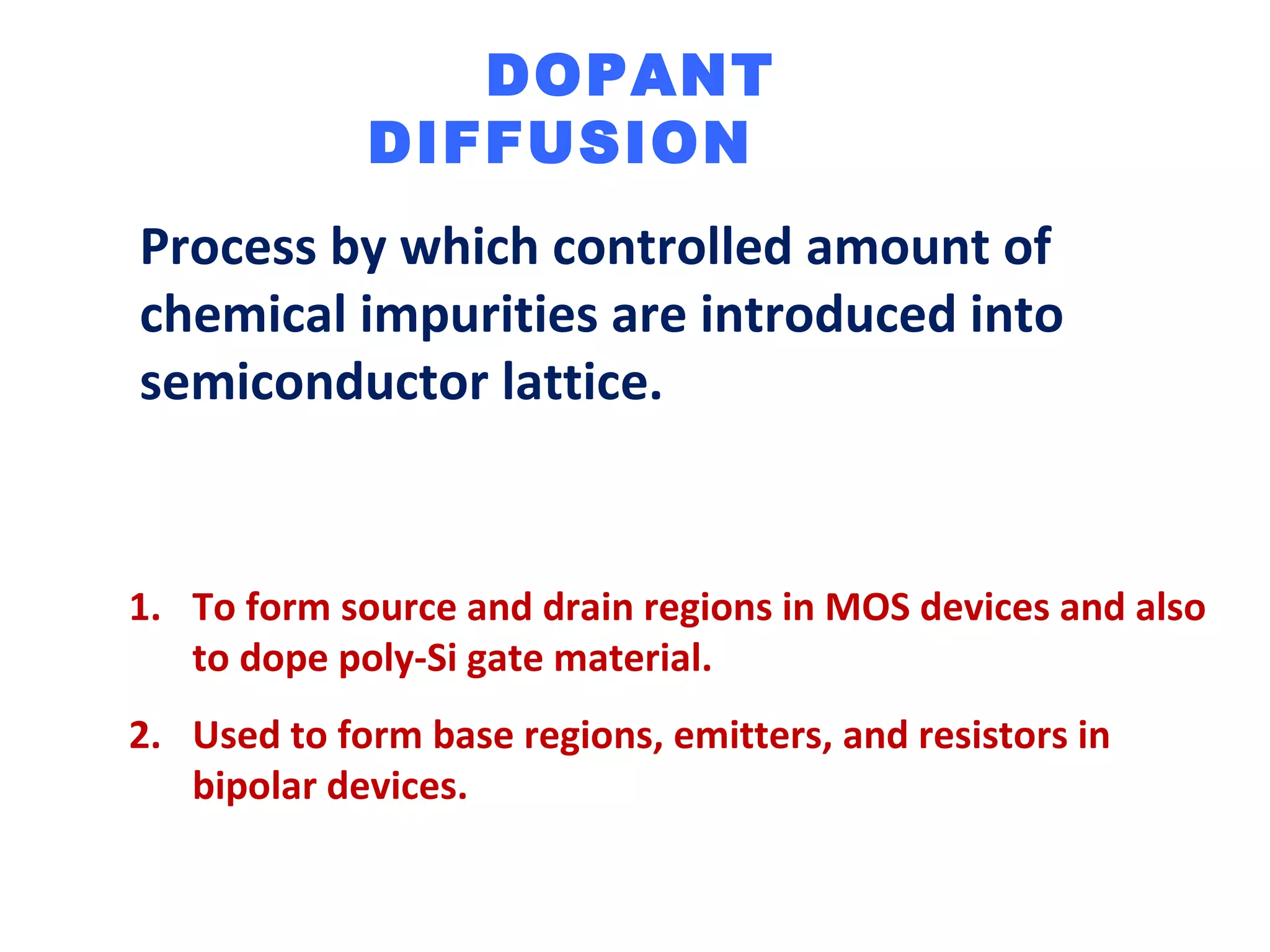

Dopant Diffusion
DOPANT
DIFFUSION
1. To form source and drain regions in MOS devices and also
to dope poly-Si gate material.
2. Used to form base regions, emitters, and resistors in
bipolar devices.
Process by which controlled amount of
chemical impurities are introduced into
semiconductor lattice.
Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani

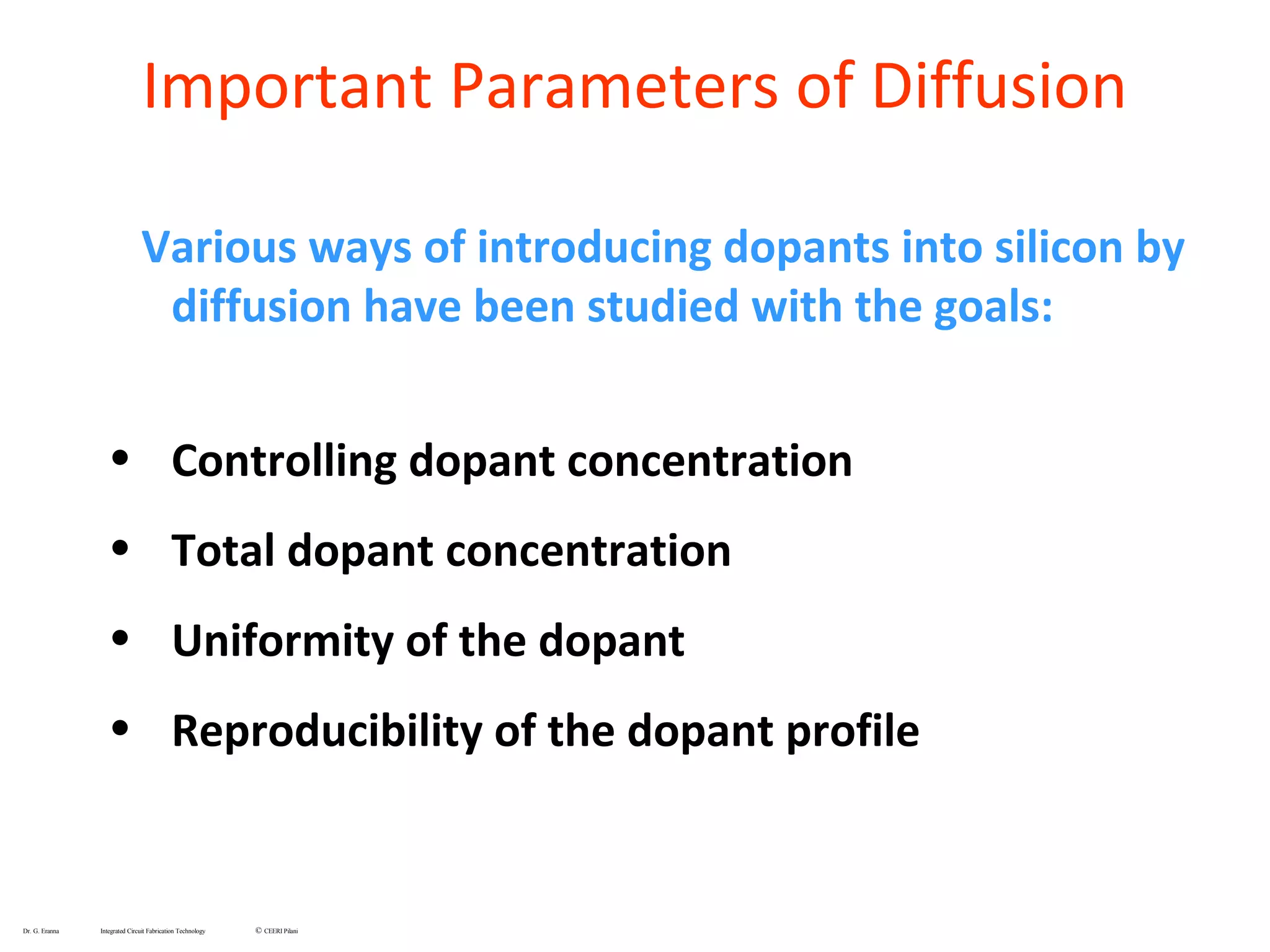

Various ways of introducing dopants into silicon by
diffusion have been studied with the goals:
• Controlling dopant concentration
• Total dopant concentration
• Uniformity of the dopant
• Reproducibility of the dopant profile
Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani

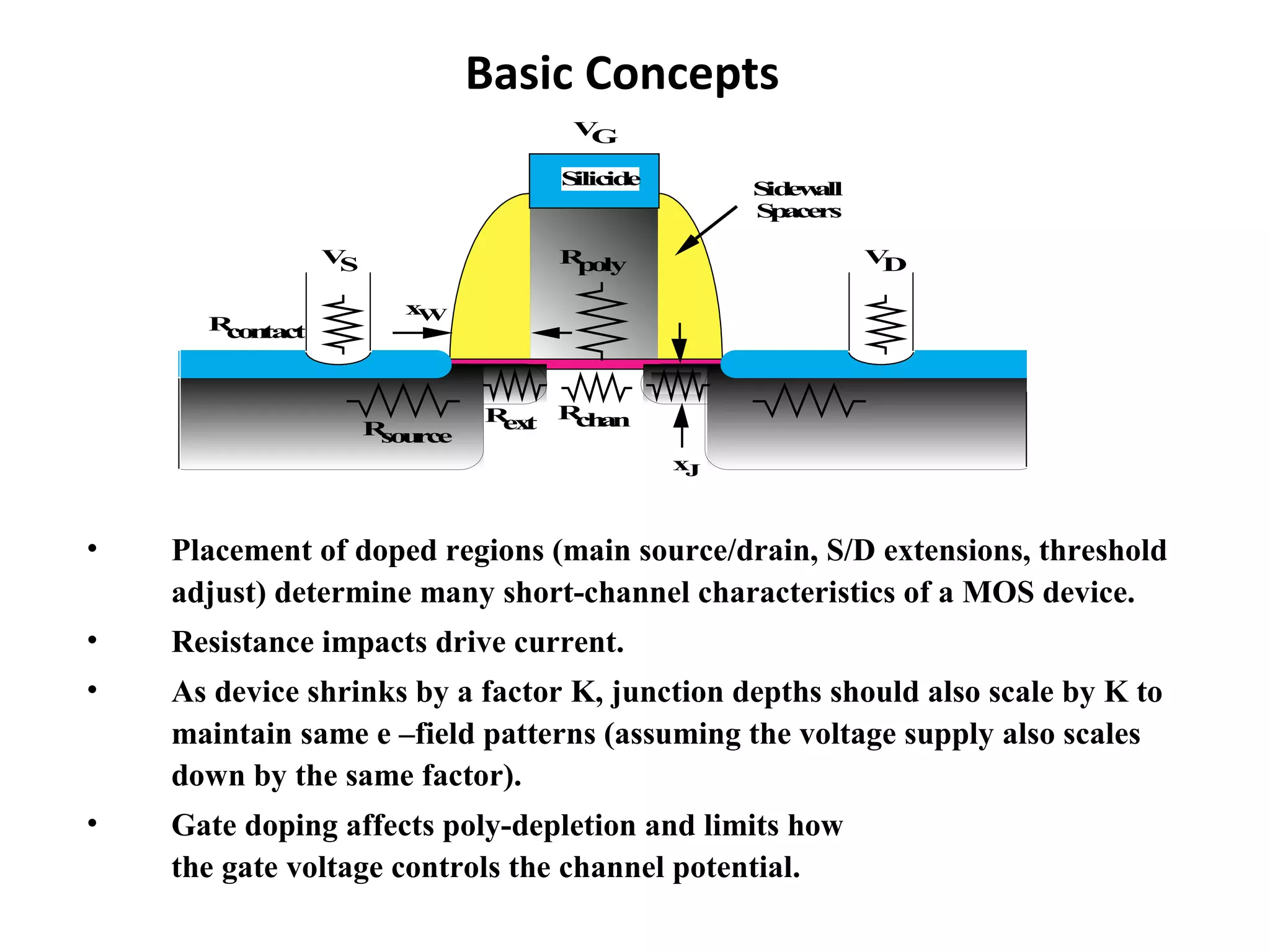

Important Parameters of Diffusion
Basic Concepts
• Placement of doped regions (main source/drain, S/D extensions, threshold
adjust) determine many short-channel characteristics of a MOS device.
• Resistance impacts drive current.
• As device shrinks by a factor K, junction depths should also scale by K to
maintain same e –field patterns (assuming the voltage supply also scales
down by the same factor).
• Gate doping affects poly-depletion and limits how
the gate voltage controls the channel potential.
Rcontact
Rsource
Rext Rchan
Rpoly
Silicide
VG
VS VD
Sidewall
Spacers
xJ
xW

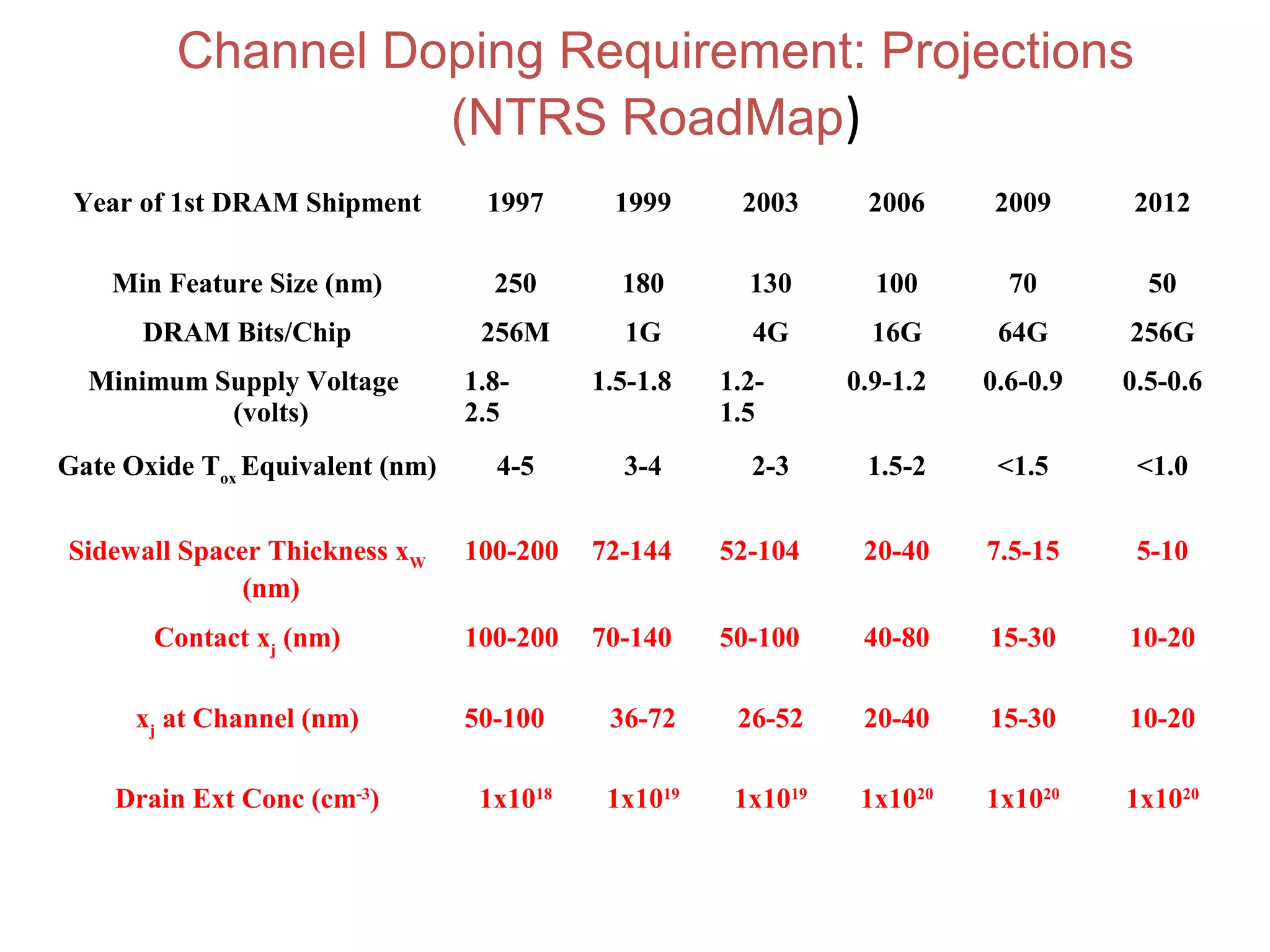

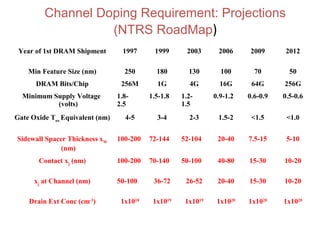

Channel Doping Requirement: Projections
(NTRS RoadMap)
Year of 1st DRAM Shipment 1997 1999 2003 2006 2009 2012
Min Feature Size (nm) 250 180 130 100 70 50
DRAM Bits/Chip 256M 1G 4G 16G 64G 256G
Minimum Supply Voltage
(volts)
1.8-
2.5
1.5-1.8 1.2-
1.5
0.9-1.2 0.6-0.9 0.5-0.6
Gate Oxide Tox
Equivalent (nm) 4-5 3-4 2-3 1.5-2 <1.5 <1.0
Sidewall Spacer Thickness xW
(nm)
100-200 72-144 52-104 20-40 7.5-15 5-10
Contact xj
(nm) 100-200 70-140 50-100 40-80 15-30 10-20
xj
at Channel (nm) 50-100 36-72 26-52 20-40 15-30 10-20
Drain Ext Conc (cm-3
) 1x1018
1x1019
1x1019
1x1020
1x1020
1x1020

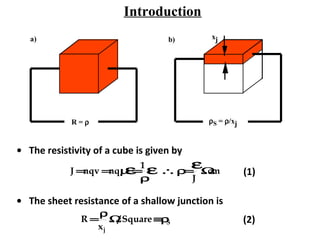

Introduction
R = ρ ρS = ρ/xj
xja) b)
• The resistivity of a cube is given by
J =nqv =nqµε=
1
ρ
ε ∴ρ=
ε
J
Ωcm (1)
• The sheet resistance of a shallow junction is
R =
ρ
xj
Ω/Square ≡ρS (2)

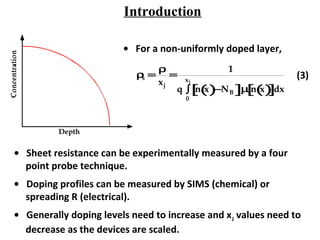

Introduction
Depth
• For a non-uniformly doped layer,
ρs =
ρ
xj
=
1
q n x()−NB[ ]
0
xj
∫ µn x()[ ]dx
(3)
• Sheet resistance can be experimentally measured by a four
point probe technique.

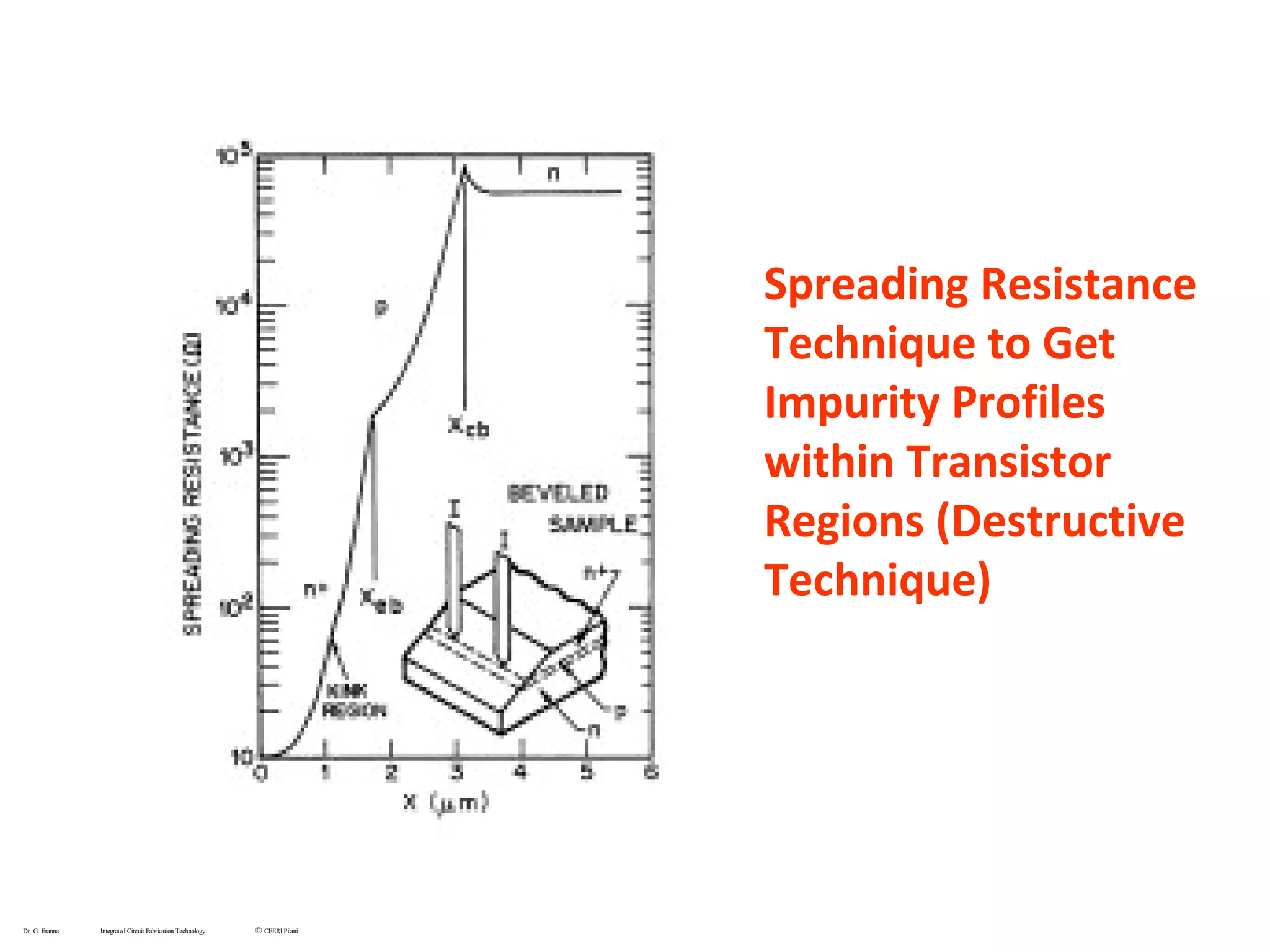

• Doping profiles can be measured by SIMS (chemical) or
spreading R (electrical).
• Generally doping levels need to increase and xJ values need to
decrease as the devices are scaled.

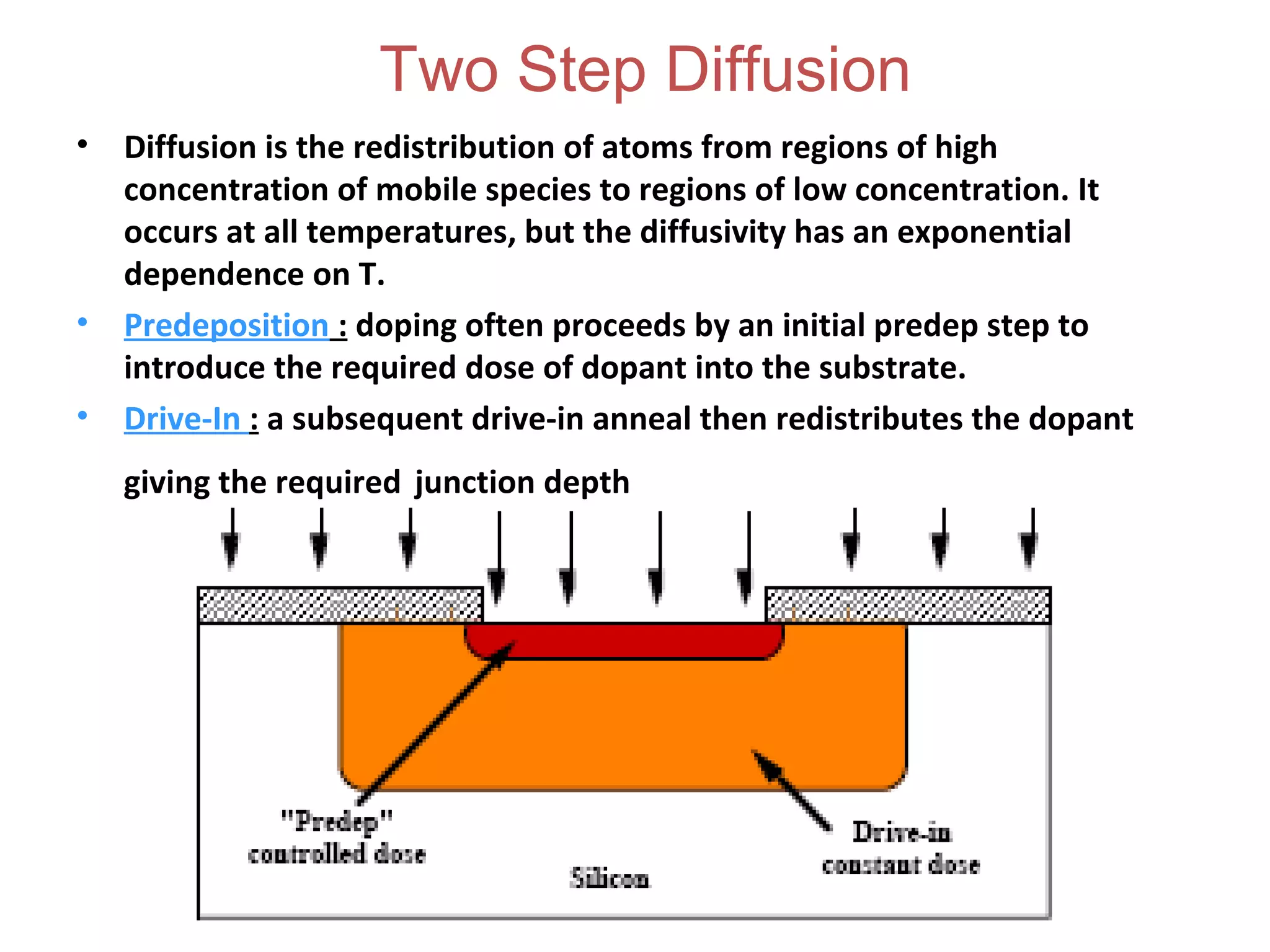

Two Step Diffusion
• Diffusion is the redistribution of atoms from regions of high
concentration of mobile species to regions of low concentration. It
occurs at all temperatures, but the diffusivity has an exponential
dependence on T.
• Predeposition : doping often proceeds by an initial predep step to
introduce the required dose of dopant into the substrate.
• Drive-In : a subsequent drive-in anneal then redistributes the dopant
giving the required junction depth
Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani

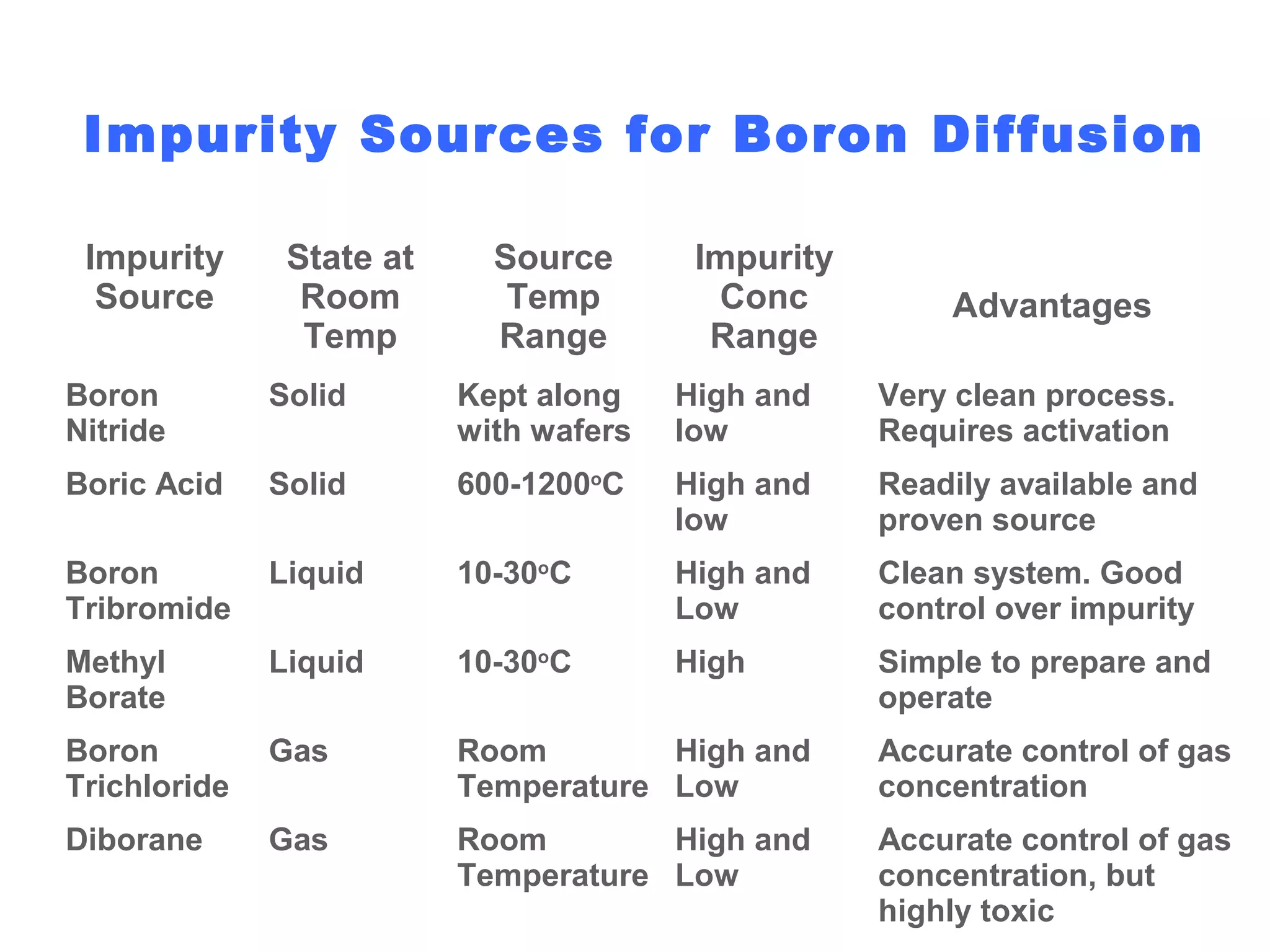

Impurity Sources for Boron Diffusion
Impurity
Source
State at
Room
Temp
Source
Temp
Range
Impurity
Conc
Range
Advantages
Boron
Nitride
Solid Kept along
with wafers
High and
low
Very clean process.
Requires activation
Boric Acid Solid 600-1200o
C High and
low
Readily available and
proven source
Boron
Tribromide
Liquid 10-30o
C High and
Low
Clean system. Good
control over impurity
Methyl
Borate
Liquid 10-30o
C High Simple to prepare and
operate
Boron
Trichloride
Gas Room
Temperature
High and
Low
Accurate control of gas
concentration
Diborane Gas Room
Temperature
High and
Low
Accurate control of gas
concentration, but
highly toxic

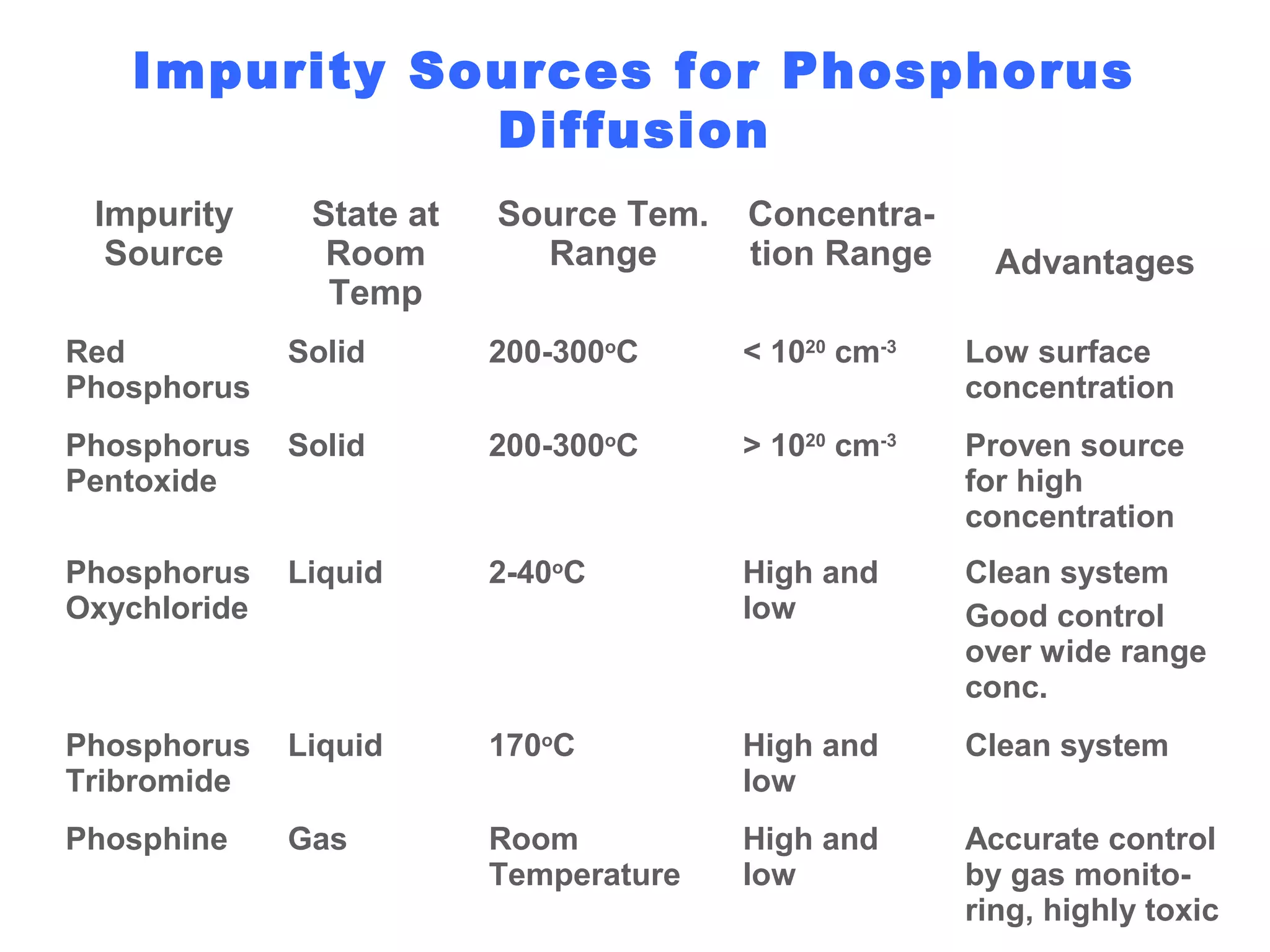

Impurity Sources for Phosphorus
Diffusion
Impurity
Source
State at
Room
Temp
Source Tem.
Range
Concentra-
tion Range Advantages
Red
Phosphorus
Solid 200-300o
C < 1020
cm-3
Low surface
concentration
Phosphorus
Pentoxide
Solid 200-300o
C > 1020
cm-3
Proven source
for high
concentration
Phosphorus
Oxychloride
Liquid 2-40o
C High and
low
Clean system
Good control
over wide range
conc.
Phosphorus
Tribromide
Liquid 170o
C High and
low
Clean system
Phosphine Gas Room
Temperature
High and
low
Accurate control
by gas monito-
ring, highly toxic

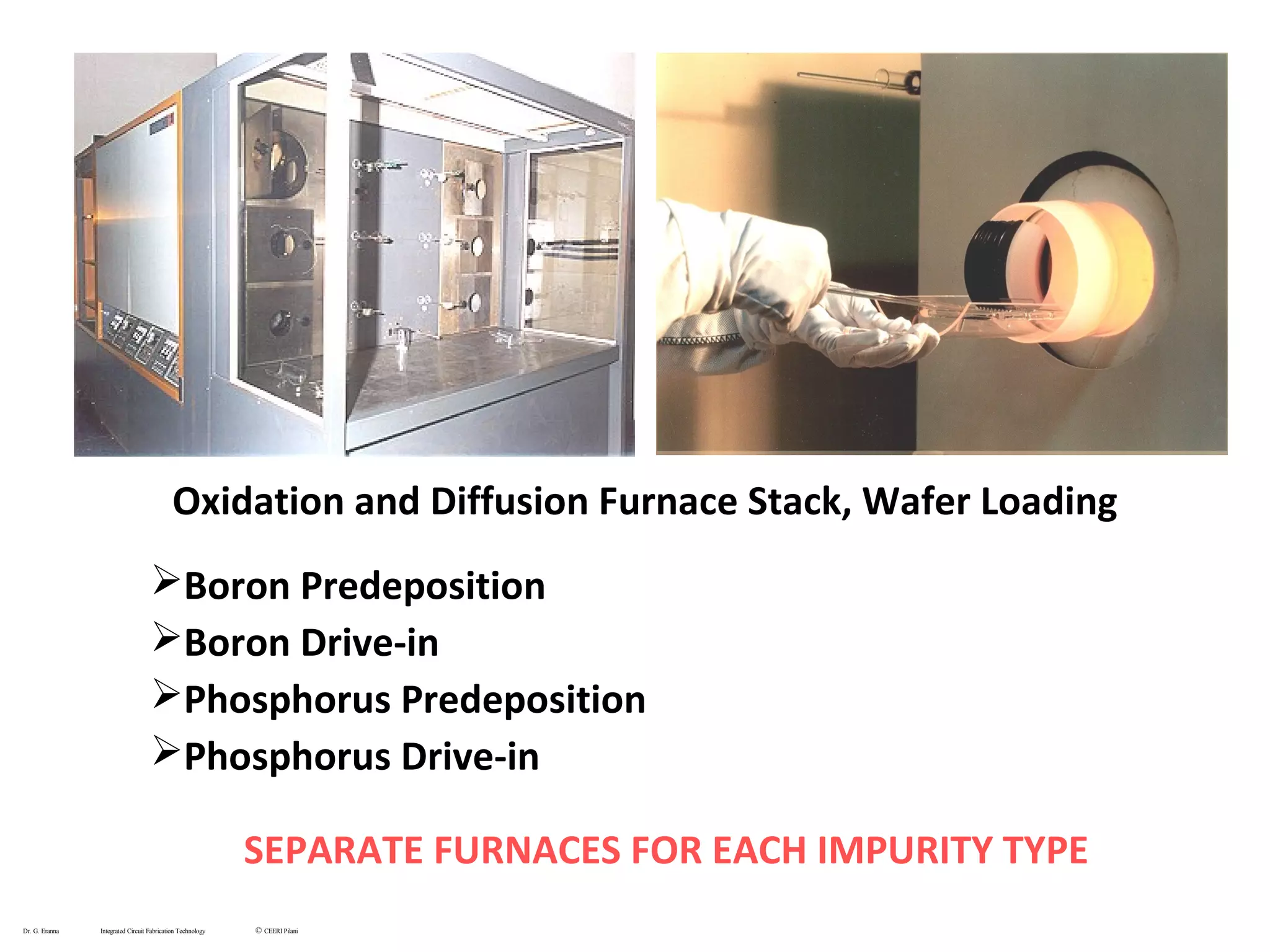

Oxidation and Diffusion Furnace Stack, Wafer Loading
Boron Predeposition
Boron Drive-in
Phosphorus Predeposition
Phosphorus Drive-in
SEPARATE FURNACES FOR EACH IMPURITY TYPE
Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani

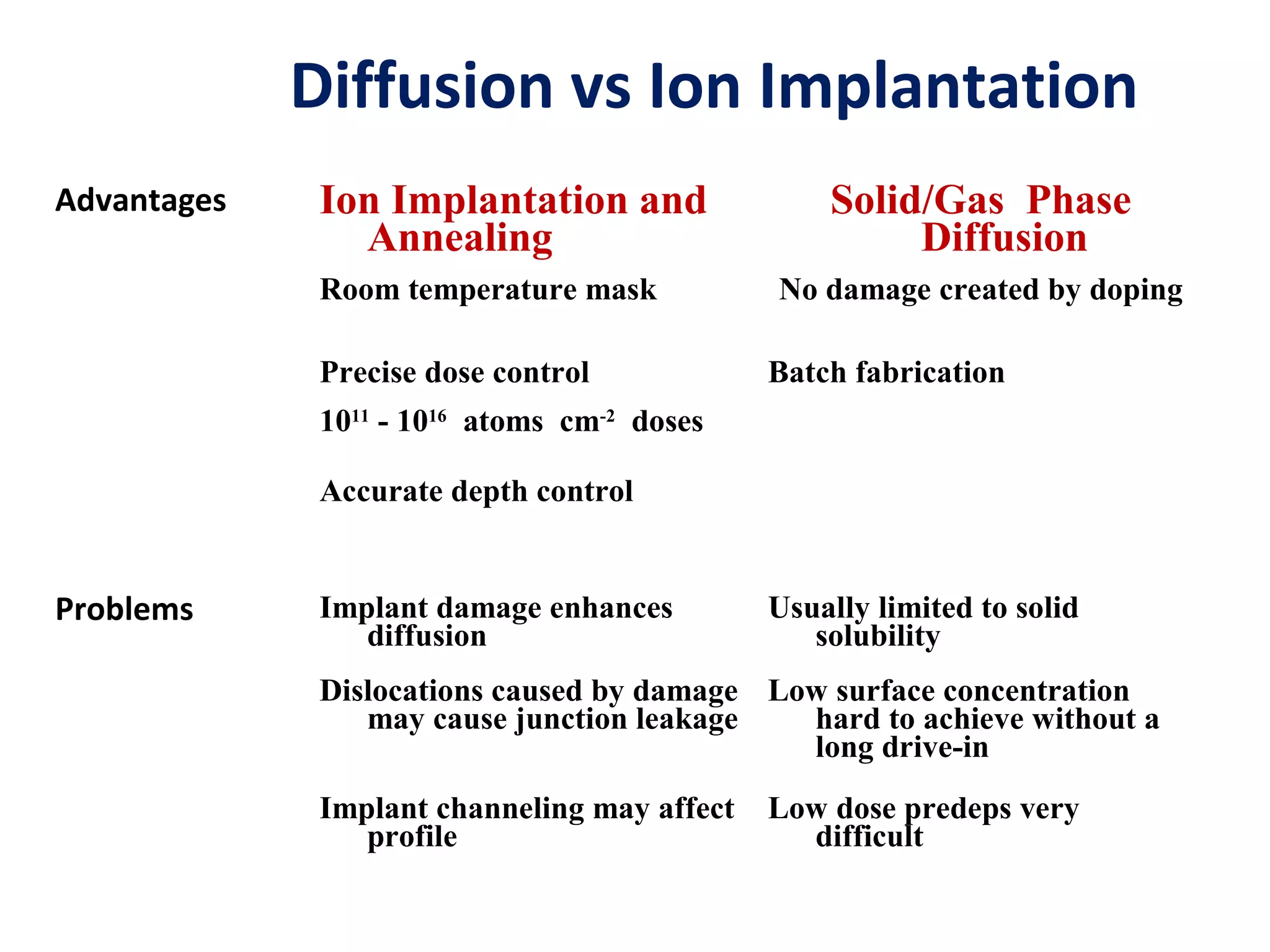

Diffusion vs Ion Implantation
Advantages
Problems
Ion Implantation and
Annealing
Solid/Gas Phase
Diffusion
Room temperature mask No damage created by doping
Precise dose control Batch fabrication
1011
- 1016
atoms cm-2
doses
Accurate depth control
Implant damage enhances
diffusion
Usually limited to solid
solubility
Dislocations caused by damage
may cause junction leakage
Low surface concentration
hard to achieve without a
long drive-in
Implant channeling may affect
profile
Low dose predeps very
difficult

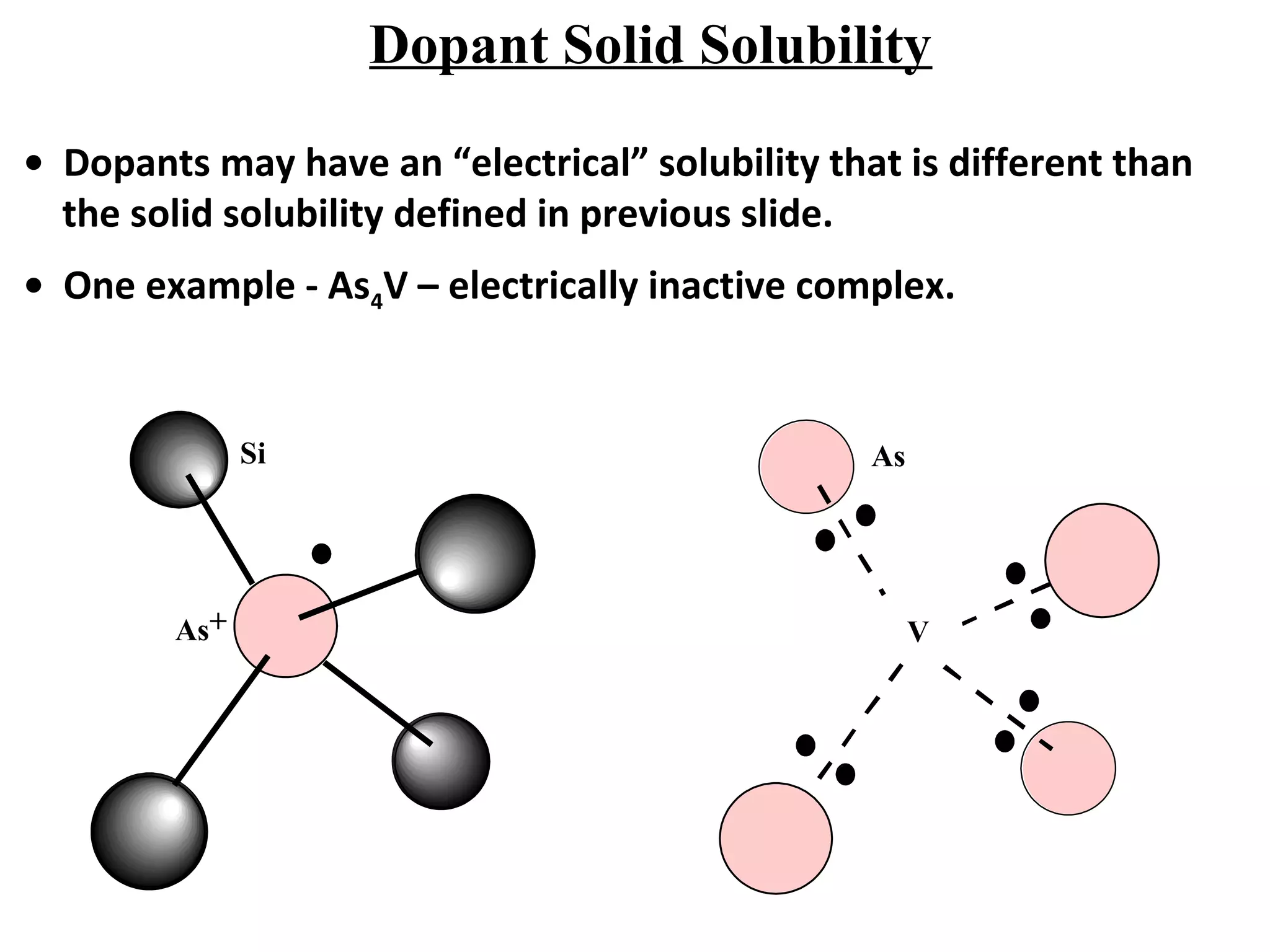

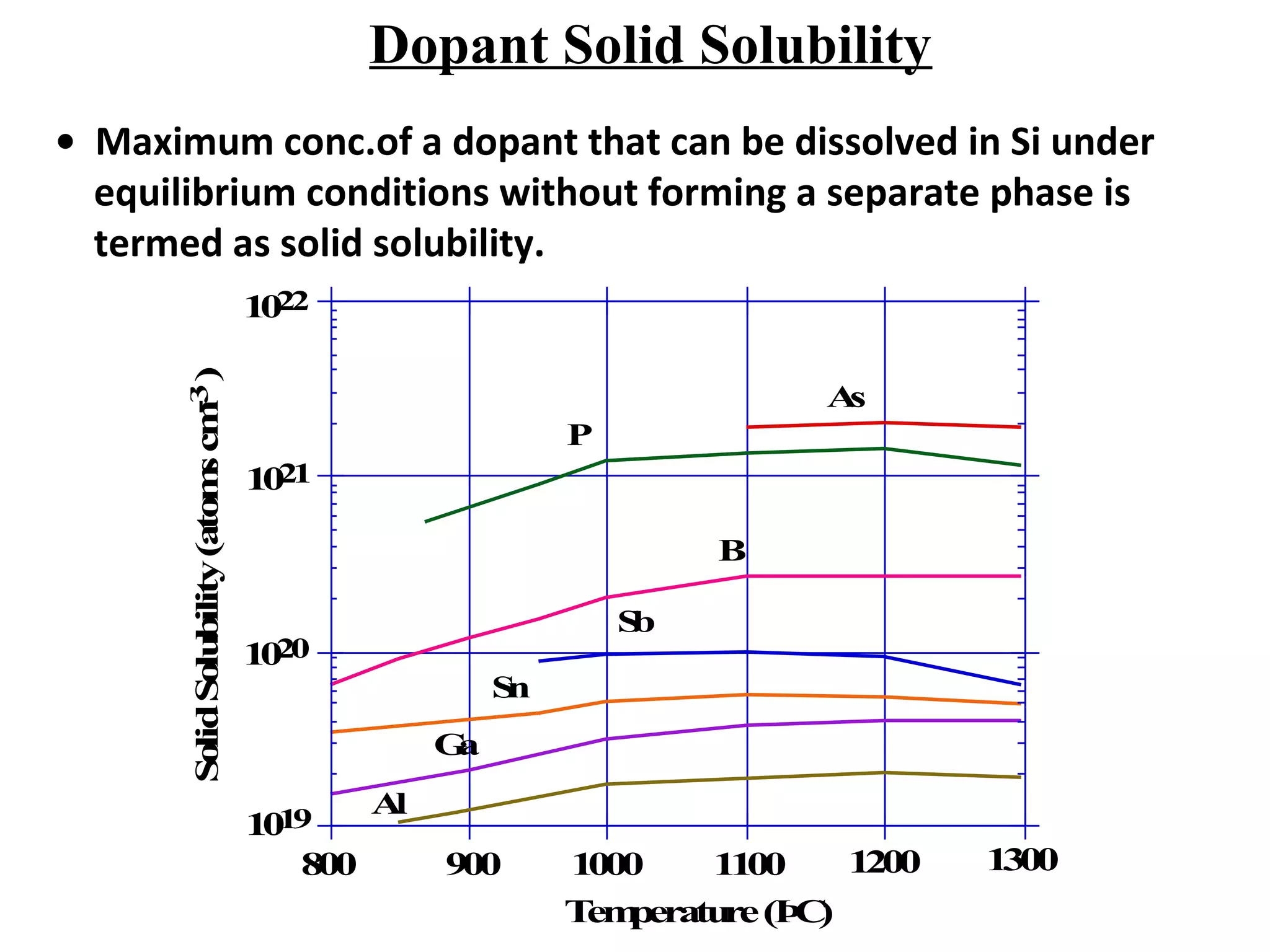

Dopant Solid Solubility
• Maximum conc.of a dopant that can be dissolved in Si under
equilibrium conditions without forming a separate phase is
termed as solid solubility.
.
As
P
Sb
Sn
Ga
Al
B
SolidSolubility(atomscm-3)
1022
1020
1021
1019
Temperature(ÞC)
800 900 1000 1100 1200 1300
• Dopants may have an “electrical” solubility that is different than
the solid solubility defined in previous slide.
• One example - As4V – electrically inactive complex.
V
Si As
As+
Dopant Solid Solubility

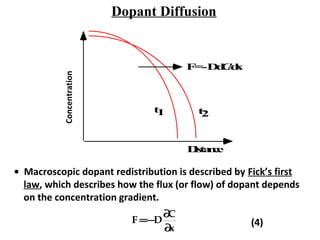

Dopant Diffusion
t1 t2
Concentration F=-DdC/dx
Distance
Concentration
• Macroscopic dopant redistribution is described by Fick’s first
law, which describes how the flux (or flow) of dopant depends
on the concentration gradient.
F =−D
∂C
∂x
(4)

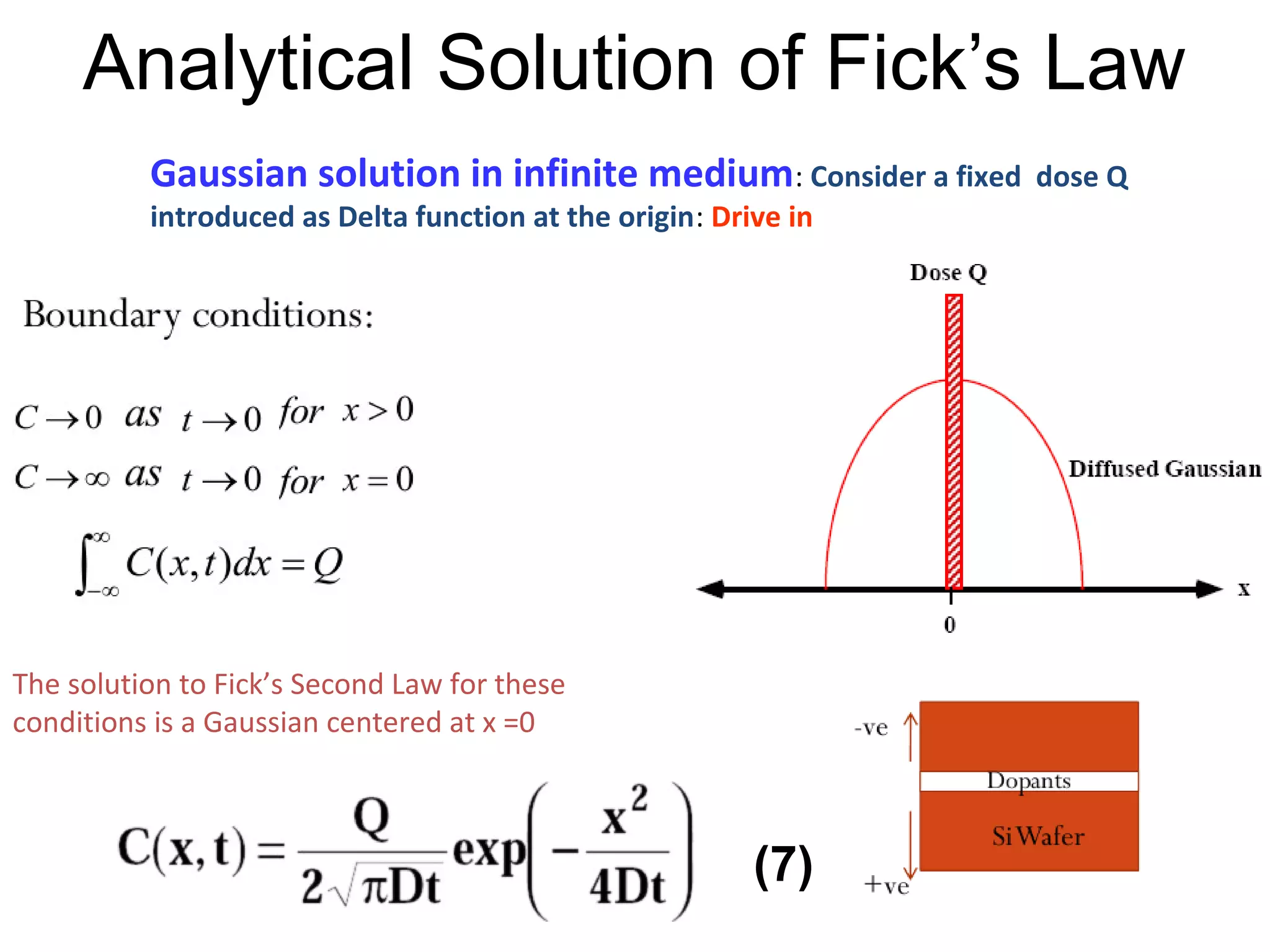

Analytical Solution of Fick’s Law
( ) ( )
( ) ( ) constQdxtxctc
dxt0,dc0,xxc
===∞
=≠=
∫
∞
,,0,
,0/00,
The solution to Fick’s Second Law for these
conditions is a Gaussian centered at x =0
Gaussian solution in infinite medium: Consider a fixed dose Q
introduced as Delta function at the origin: Drive in
(7)

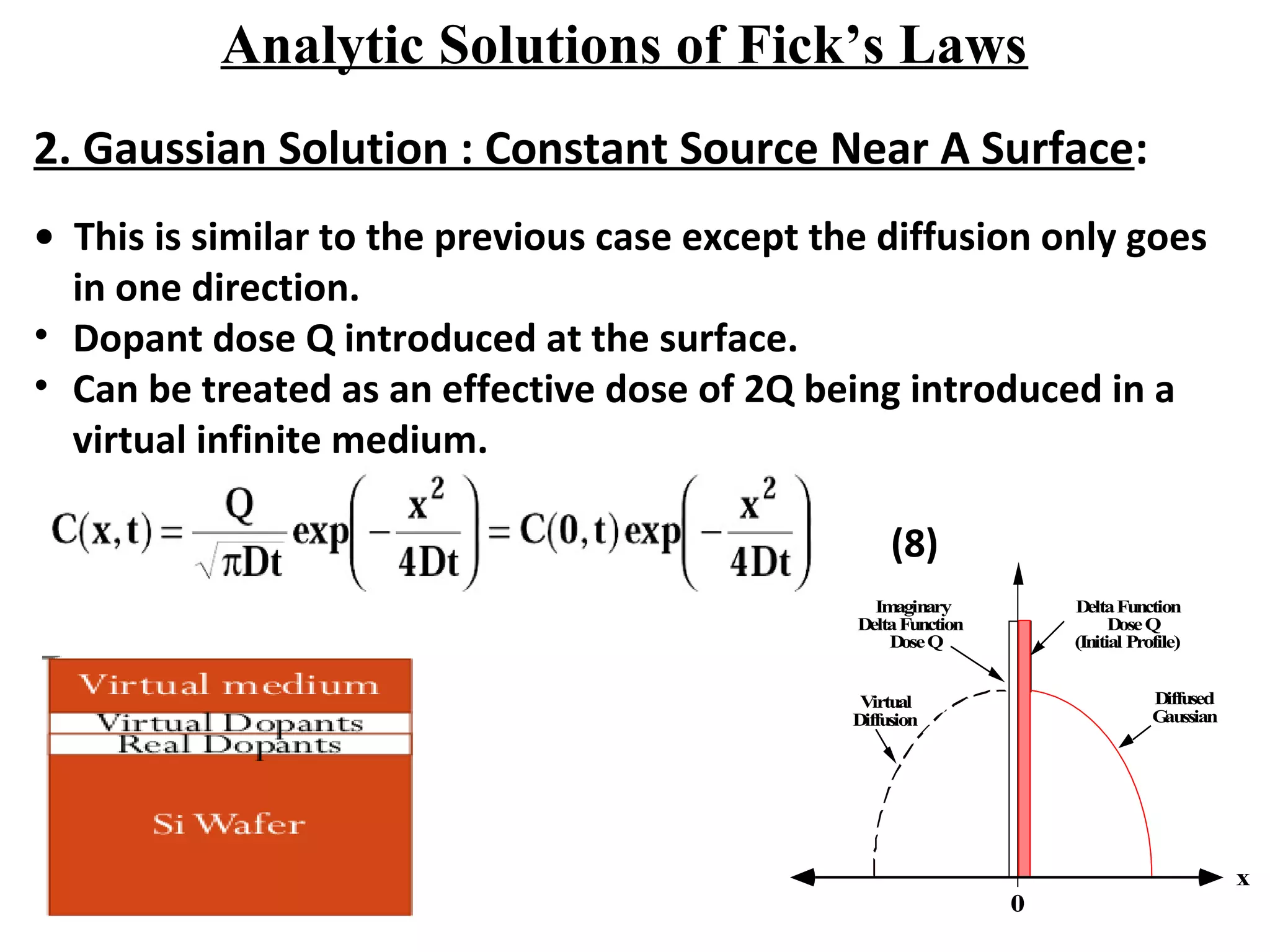

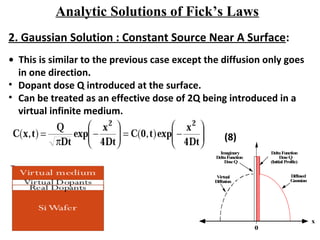

2. Gaussian Solution : Constant Source Near A Surface:
Analytic Solutions of Fick’s Laws
• This is similar to the previous case except the diffusion only goes
in one direction.
• Dopant dose Q introduced at the surface.
• Can be treated as an effective dose of 2Q being introduced in a
virtual infinite medium.
DeltaFunction
DoseQ
(Initial Profile)
Imaginary
DeltaFunction
DoseQ
Diffused
Gaussian
Virtual
Diffusion
x
0
(8)
Analytic Solutions of Fick’s Laws

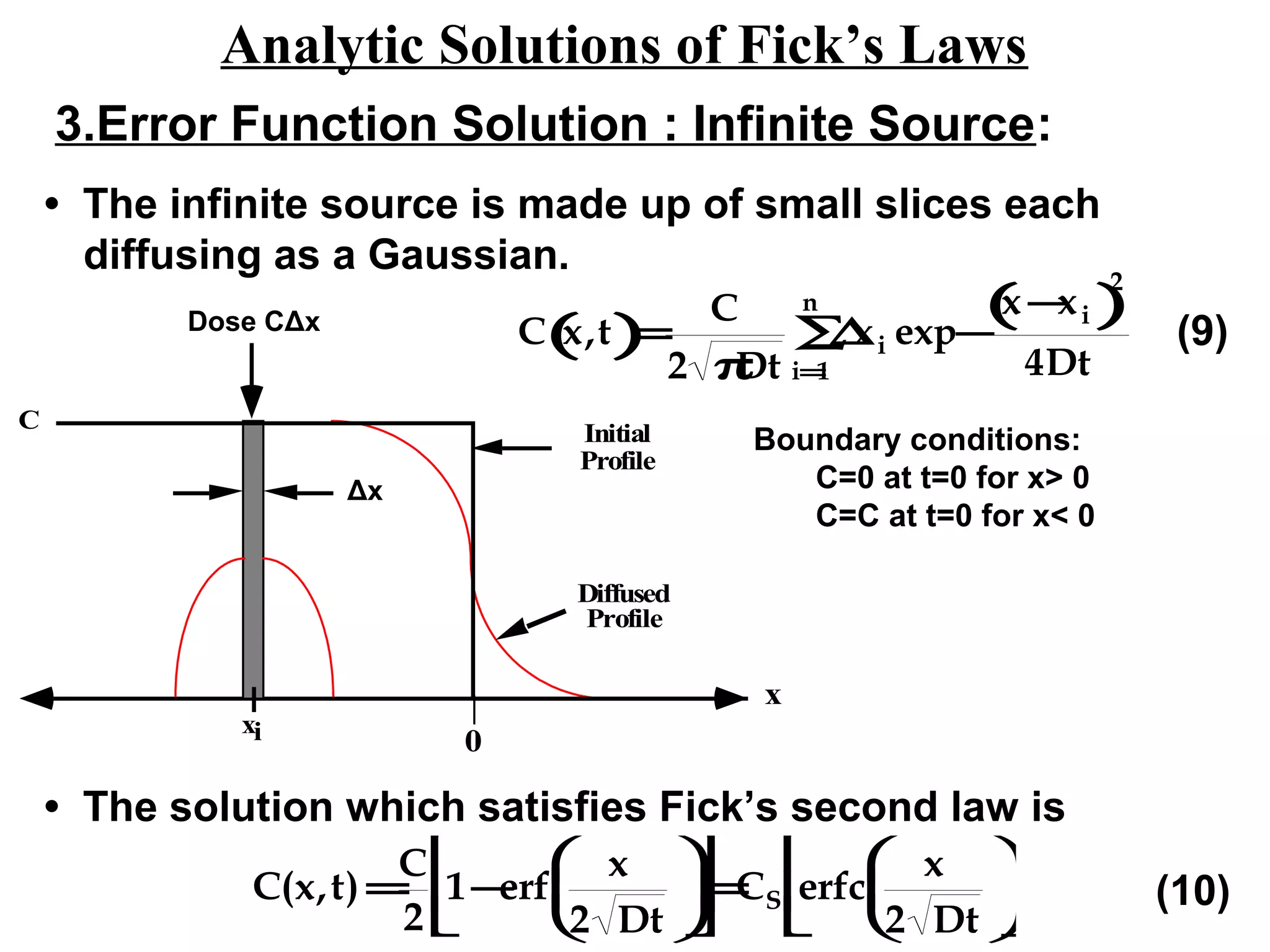

3.Error Function Solution : Infinite Source:
• The infinite source is made up of small slices each
diffusing as a Gaussian.
C x,t( )=
C
2 πDt
∆xi exp−
x −xi( )
2
4Dti=1
n
∑ (9)
• The solution which satisfies Fick’s second law is
C(x,t) =
C
2
1−erf
x
2 Dt











=CS erfc
x
2 Dt











 (10)
C
² x
Dose C² x
Initial
Profile
Diffused
Profile
xi
x
0
Dose CΔx
Δx
Boundary conditions:
C=0 at t=0 for x> 0
C=C at t=0 for x< 0

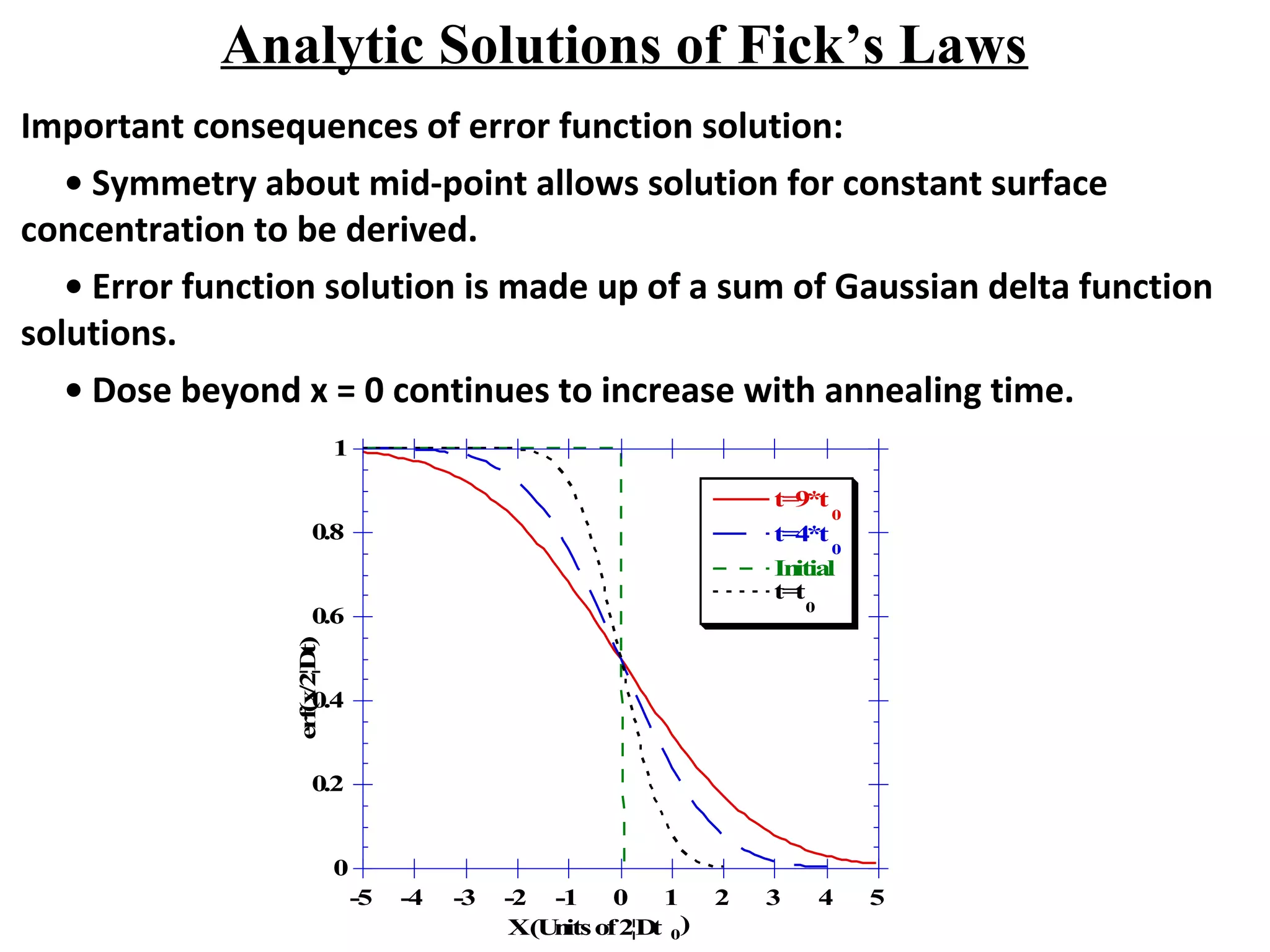

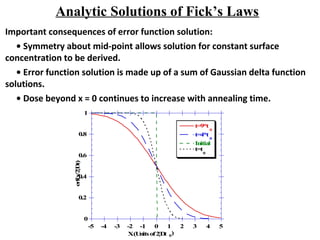

Analytic Solutions of Fick’s Laws
Important consequences of error function solution:
• Symmetry about mid-point allows solution for constant surface
concentration to be derived.
• Error function solution is made up of a sum of Gaussian delta function
solutions.

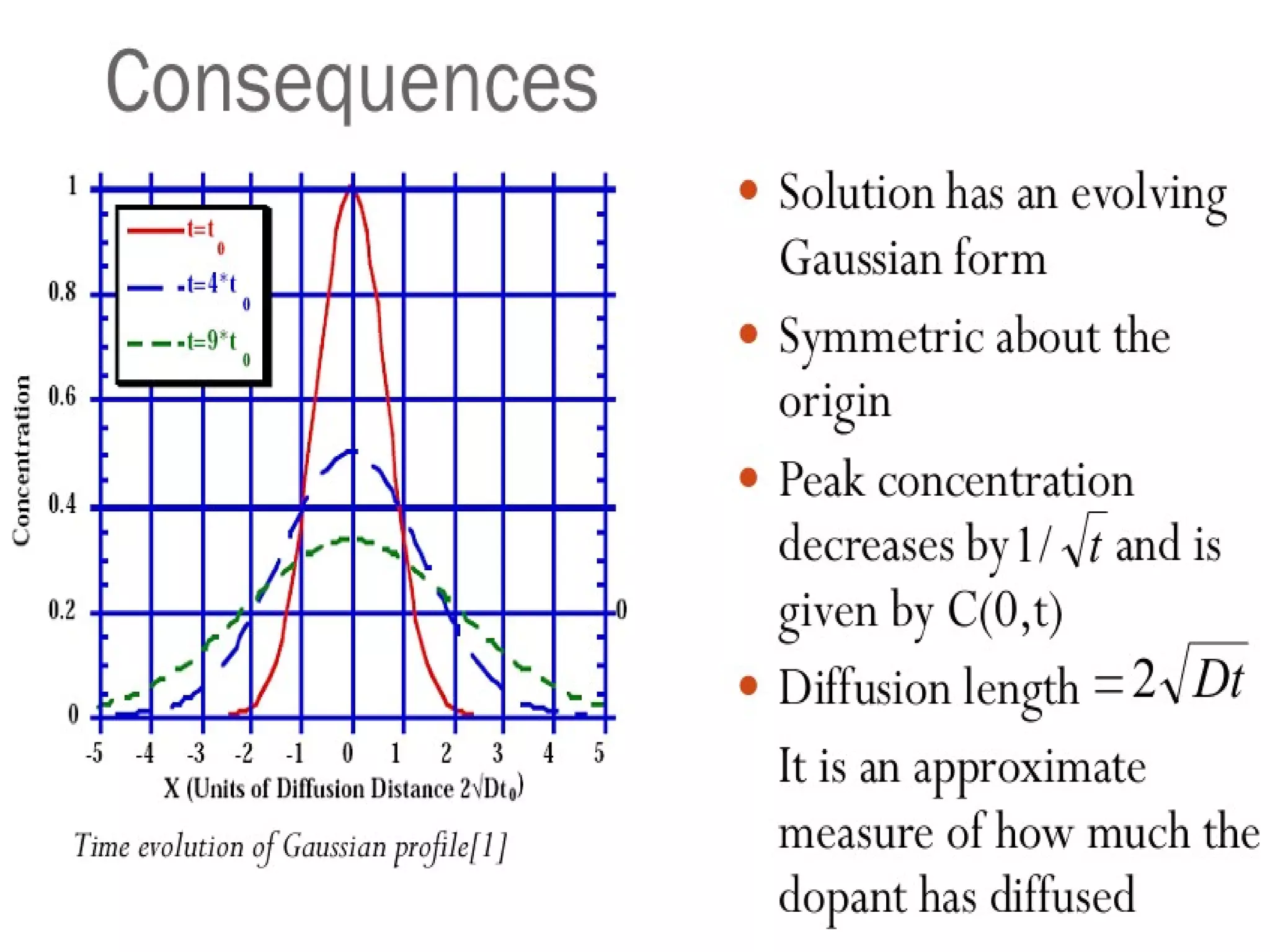

• Dose beyond x = 0 continues to increase with annealing time.
.
0
0.2
0.4
0.6
0.8
1
-5 -4 -3 -2 -1 0 1 2 3 4 5
t=9*t
0
t=4*t
0
Initial
t=t
0
erf(x/2¦Dt)
X(Unitsof2¦Dt 0
)
Analytic Solutions of Fick’s Laws

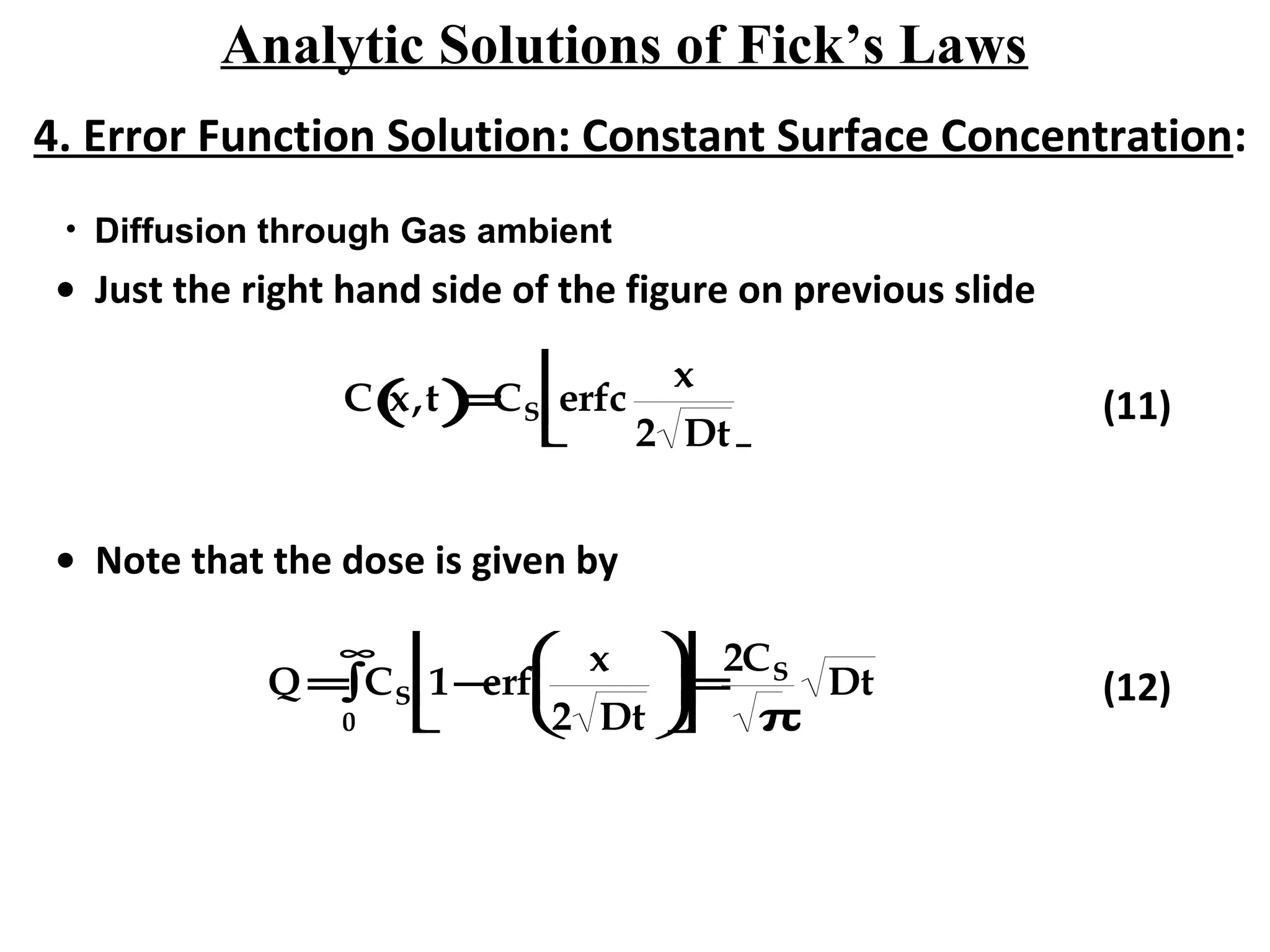

4. Error Function Solution: Constant Surface Concentration:
• Just the right hand side of the figure on previous slide
C x,t( )=CS erfc
x
2 Dt





 (11)
• Note that the dose is given by
Q = CS
0
∞
∫ 1−erf
x
2 Dt











=
2CS
π
Dt (12)
• Diffusion through Gas ambient

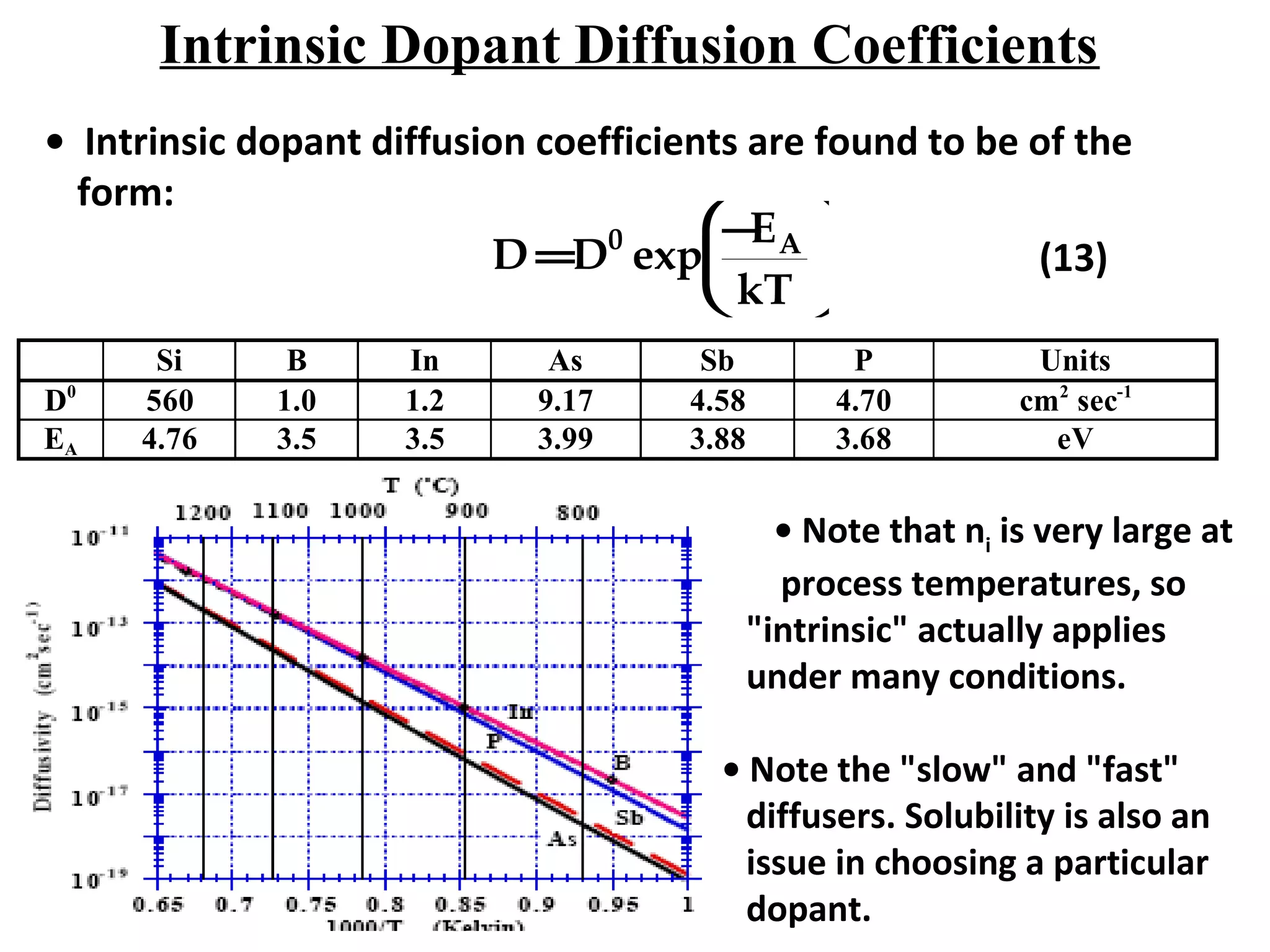

Intrinsic Dopant Diffusion Coefficients
• Intrinsic dopant diffusion coefficients are found to be of the
form:
D =D0
exp
−EA
kT





 (13)
Si B In As Sb P Units
D0
560 1.0 1.2 9.17 4.58 4.70 cm2
sec-1
EA 4.76 3.5 3.5 3.99 3.88 3.68 eV
• Note that ni is very large at
process temperatures, so
"intrinsic" actually applies
under many conditions.
• Note the "slow" and "fast"
diffusers. Solubility is also an
issue in choosing a particular
dopant.
Effect of Successive Diffusions
• If a dopant is diffused at temperature T1 for time t1 and then is
diffused at temperature T2 for time t2, the total effective Dt is
given by the sum of all the individual Dt products.
Dteff =Dt =D1∑ t1 +D2t2 +..... (14)
• The Gaussian solution only holds if the Dt used to introduce the
dopant is small compared with the final Dt for the drive-in; i.e. if
an initial delta function approximation is reasonable.

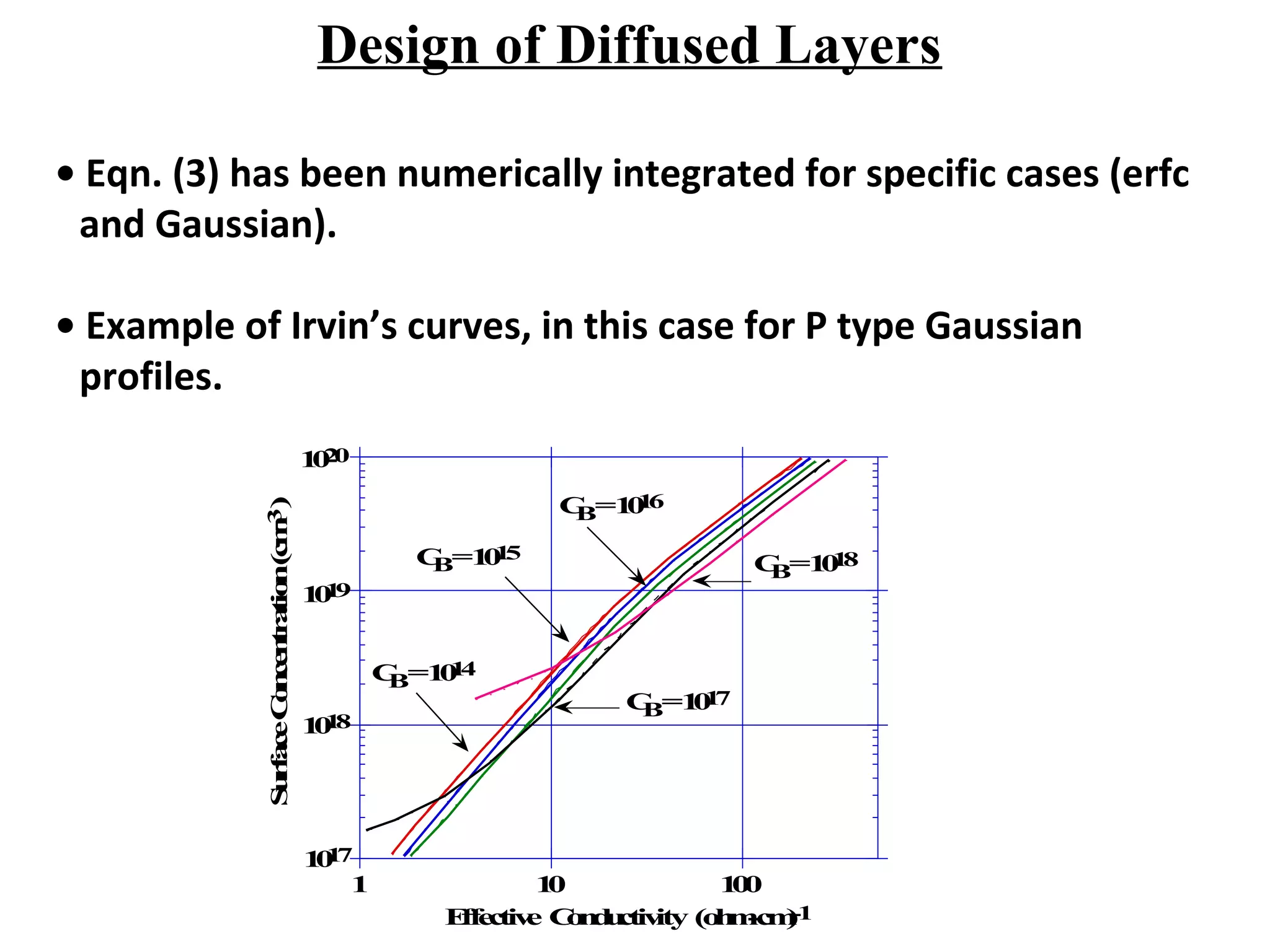

Design of Diffused Layers
• Eqn. (3) has been numerically integrated for specific cases (erfc
and Gaussian).
• Example of Irvin’s curves, in this case for P type Gaussian
profiles.
1 10 100
Effective Conductivity (ohm-cm)-1
SurfaceConcentration(cm-3)
CB=1015
CB=1017
CB=1014
CB=1016
CB=1018
1020
1019
1018
1017

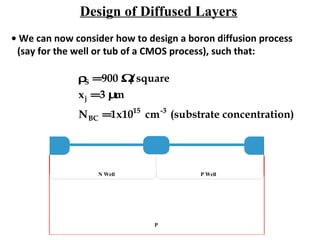

Design of Diffused Layers
• We can now consider how to design a boron diffusion process
(say for the well or tub of a CMOS process), such that:
P
P WellN Well
ρS =900 Ω/square
xj =3 µm
NBC =1x1015
cm-3
(substrate concentration)
Design of Diffused Layers
• The average conductivity of the layer is
σ
_
=
1
ρSxj
=
1
(900Ω/sq)(3×10−4
cm)
=3.7 Ω⋅cm( )
−1
• From Irvin’s curve we obtain
CS ≈4×1017
/cm3
• We can surmise that the profile is Gaussian after drive-in.
∴CBC =
Q
πDt
exp −
xj
2
4Dt








=CS exp −
xj
2
4Dt








so that Dt =
Xj
2
4ln
Cs
Cbc
=
3x10−4
( )
2
4ln
4x1017
1015






=3.7x10−9
cm2

Design of Diffused Layers
• If the drive-in is done at 1100 ˚C, then the boron diffusivity is
D =1.5×10−13
cm2
sec−1
• The drive-in time is therefore
tdrive−in =
3.7×10−9
cm2
1.5×10−13
cm2
/ sec
=6.8 hours
• Given both the surface concentration and Dt, the initial dose can
be calculated for this Gaussian profile.
Q =CS πDt =4×1017
( )π()3.7×10−9
( )=4.3×1013
cm−2
• This dose could easily be implanted in a narrow layer close to the
surface, justifying the implicit assumption in the Gaussian profile
that the initial distribution approximates a delta function.

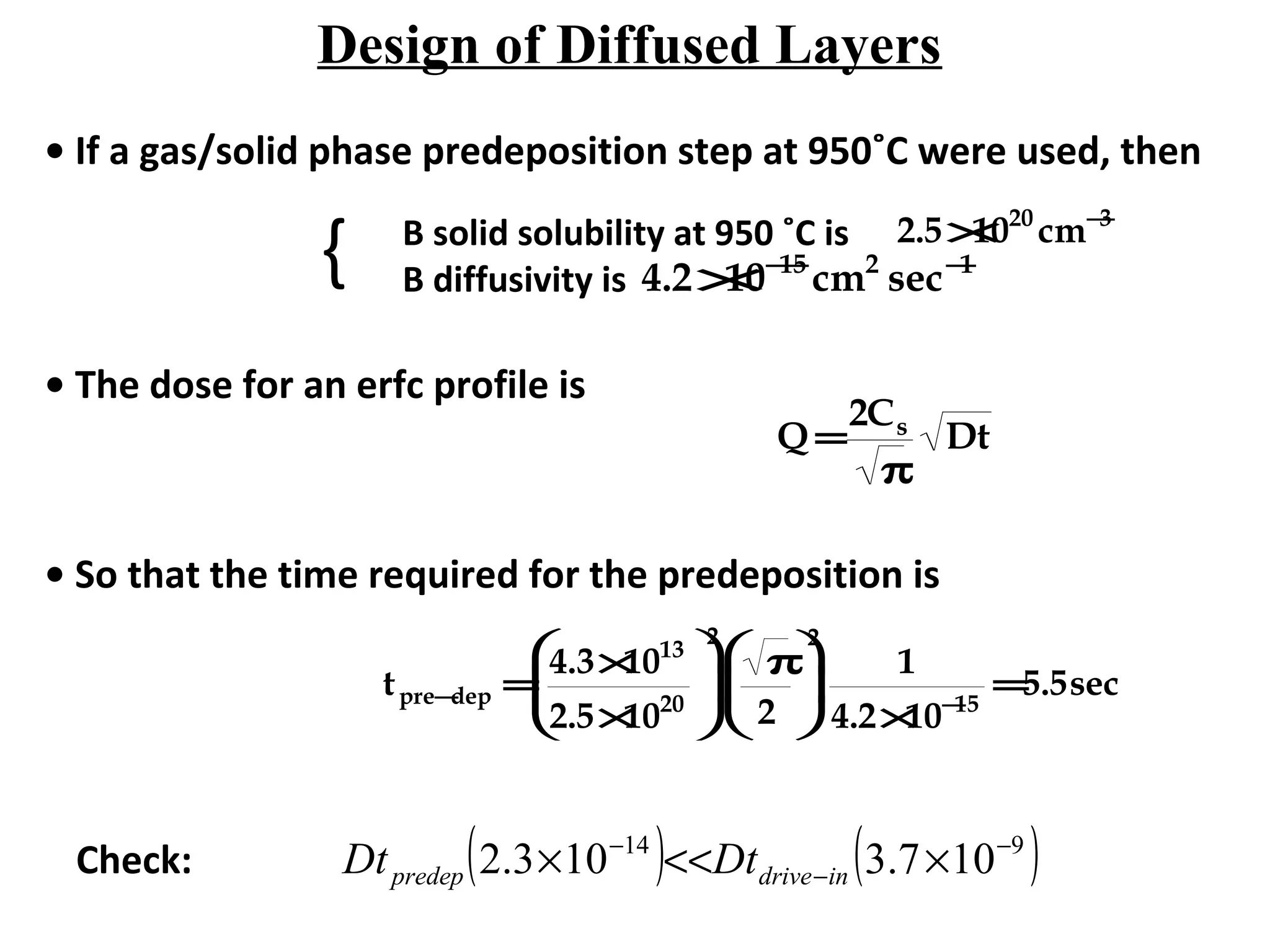

Design of Diffused Layers
• If a gas/solid phase predeposition step at 950˚C were used, then
B solid solubility at 950 ˚C is
B diffusivity is
2.5×1020
cm−3
4.2×10−15
cm2
sec−1{
• The dose for an erfc profile is
Q =
2Cs
π
Dt
• So that the time required for the predeposition is
tpre−dep =
4.3×1013
2.5×1020






2
π
2






2
1
4.2×10−15
=5.5sec
Check: ( ) ( )914
107.3103.2 −
−
−
×<<× indrivepredep DtDt
Four Point Probe:
Characterization
When t << s, as in the case of diffused or implanted
layer,
Sheet Resistance
Resistivity=
Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani
Junction Depth Measurements by Grooving and
Staining
Spreading Resistance
Technique to Get
Impurity Profiles
within Transistor
Regions (Destructive
Technique)
Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani
7. dopant diffusion 1,2 2013 microtech

7. dopant diffusion 1,2 2013 microtech

  • 1.
  • 2.
    DOPANT DIFFUSION 1. To formsource and drain regions in MOS devices and also to dope poly-Si gate material. 2. Used to form base regions, emitters, and resistors in bipolar devices. Process by which controlled amount of chemical impurities are introduced into semiconductor lattice.
  • 3.
    Dr. G. ErannaIntegrated Circuit Fabrication Technology © CEERI Pilani
  • 4.
    Various ways ofintroducing dopants into silicon by diffusion have been studied with the goals: • Controlling dopant concentration • Total dopant concentration • Uniformity of the dopant • Reproducibility of the dopant profile Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani Important Parameters of Diffusion
  • 5.
    Basic Concepts • Placementof doped regions (main source/drain, S/D extensions, threshold adjust) determine many short-channel characteristics of a MOS device. • Resistance impacts drive current. • As device shrinks by a factor K, junction depths should also scale by K to maintain same e –field patterns (assuming the voltage supply also scales down by the same factor). • Gate doping affects poly-depletion and limits how the gate voltage controls the channel potential. Rcontact Rsource Rext Rchan Rpoly Silicide VG VS VD Sidewall Spacers xJ xW
  • 6.
    Channel Doping Requirement:Projections (NTRS RoadMap) Year of 1st DRAM Shipment 1997 1999 2003 2006 2009 2012 Min Feature Size (nm) 250 180 130 100 70 50 DRAM Bits/Chip 256M 1G 4G 16G 64G 256G Minimum Supply Voltage (volts) 1.8- 2.5 1.5-1.8 1.2- 1.5 0.9-1.2 0.6-0.9 0.5-0.6 Gate Oxide Tox Equivalent (nm) 4-5 3-4 2-3 1.5-2 <1.5 <1.0 Sidewall Spacer Thickness xW (nm) 100-200 72-144 52-104 20-40 7.5-15 5-10 Contact xj (nm) 100-200 70-140 50-100 40-80 15-30 10-20 xj at Channel (nm) 50-100 36-72 26-52 20-40 15-30 10-20 Drain Ext Conc (cm-3 ) 1x1018 1x1019 1x1019 1x1020 1x1020 1x1020
  • 7.
    Introduction R = ρρS = ρ/xj xja) b) • The resistivity of a cube is given by J =nqv =nqµε= 1 ρ ε ∴ρ= ε J Ωcm (1) • The sheet resistance of a shallow junction is R = ρ xj Ω/Square ≡ρS (2)
  • 8.
    Introduction Depth • For anon-uniformly doped layer, ρs = ρ xj = 1 q n x()−NB[ ] 0 xj ∫ µn x()[ ]dx (3) • Sheet resistance can be experimentally measured by a four point probe technique. • Doping profiles can be measured by SIMS (chemical) or spreading R (electrical). • Generally doping levels need to increase and xJ values need to decrease as the devices are scaled.
  • 9.

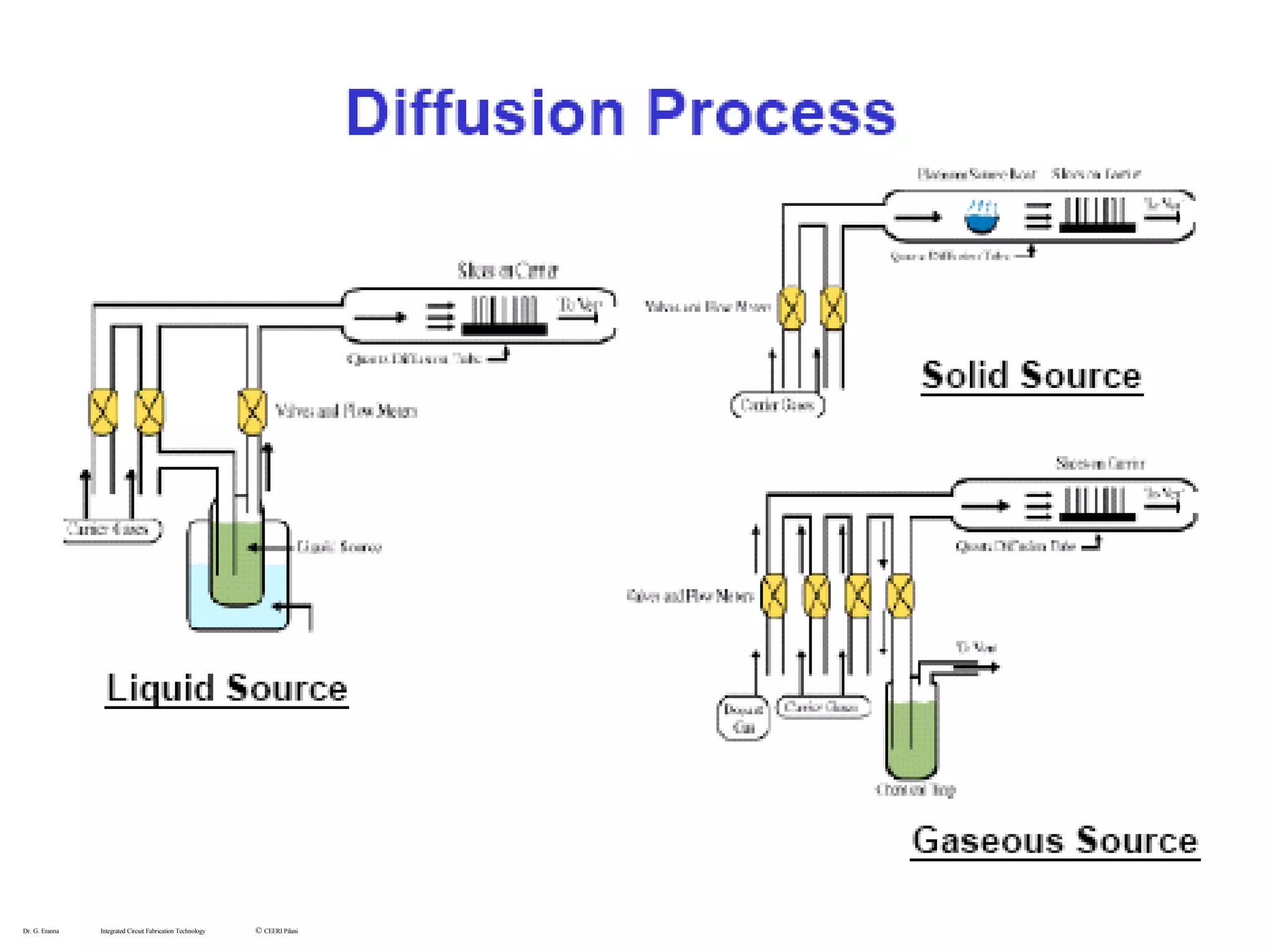

    Two Step Diffusion •Diffusion is the redistribution of atoms from regions of high concentration of mobile species to regions of low concentration. It occurs at all temperatures, but the diffusivity has an exponential dependence on T. • Predeposition : doping often proceeds by an initial predep step to introduce the required dose of dopant into the substrate. • Drive-In : a subsequent drive-in anneal then redistributes the dopant giving the required junction depth
  • 10.
    Dr. G. ErannaIntegrated Circuit Fabrication Technology © CEERI Pilani
  • 11.
    Impurity Sources forBoron Diffusion Impurity Source State at Room Temp Source Temp Range Impurity Conc Range Advantages Boron Nitride Solid Kept along with wafers High and low Very clean process. Requires activation Boric Acid Solid 600-1200o C High and low Readily available and proven source Boron Tribromide Liquid 10-30o C High and Low Clean system. Good control over impurity Methyl Borate Liquid 10-30o C High Simple to prepare and operate Boron Trichloride Gas Room Temperature High and Low Accurate control of gas concentration Diborane Gas Room Temperature High and Low Accurate control of gas concentration, but highly toxic
  • 12.
    Impurity Sources forPhosphorus Diffusion Impurity Source State at Room Temp Source Tem. Range Concentra- tion Range Advantages Red Phosphorus Solid 200-300o C < 1020 cm-3 Low surface concentration Phosphorus Pentoxide Solid 200-300o C > 1020 cm-3 Proven source for high concentration Phosphorus Oxychloride Liquid 2-40o C High and low Clean system Good control over wide range conc. Phosphorus Tribromide Liquid 170o C High and low Clean system Phosphine Gas Room Temperature High and low Accurate control by gas monito- ring, highly toxic
  • 13.
    Oxidation and DiffusionFurnace Stack, Wafer Loading Boron Predeposition Boron Drive-in Phosphorus Predeposition Phosphorus Drive-in SEPARATE FURNACES FOR EACH IMPURITY TYPE Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani
  • 14.
    Diffusion vs IonImplantation Advantages Problems Ion Implantation and Annealing Solid/Gas Phase Diffusion Room temperature mask No damage created by doping Precise dose control Batch fabrication 1011 - 1016 atoms cm-2 doses Accurate depth control Implant damage enhances diffusion Usually limited to solid solubility Dislocations caused by damage may cause junction leakage Low surface concentration hard to achieve without a long drive-in Implant channeling may affect profile Low dose predeps very difficult
  • 15.
    Dopant Solid Solubility •Maximum conc.of a dopant that can be dissolved in Si under equilibrium conditions without forming a separate phase is termed as solid solubility. . As P Sb Sn Ga Al B SolidSolubility(atomscm-3) 1022 1020 1021 1019 Temperature(ÞC) 800 900 1000 1100 1200 1300
  • 16.
    • Dopants mayhave an “electrical” solubility that is different than the solid solubility defined in previous slide. • One example - As4V – electrically inactive complex. V Si As As+ Dopant Solid Solubility
  • 17.

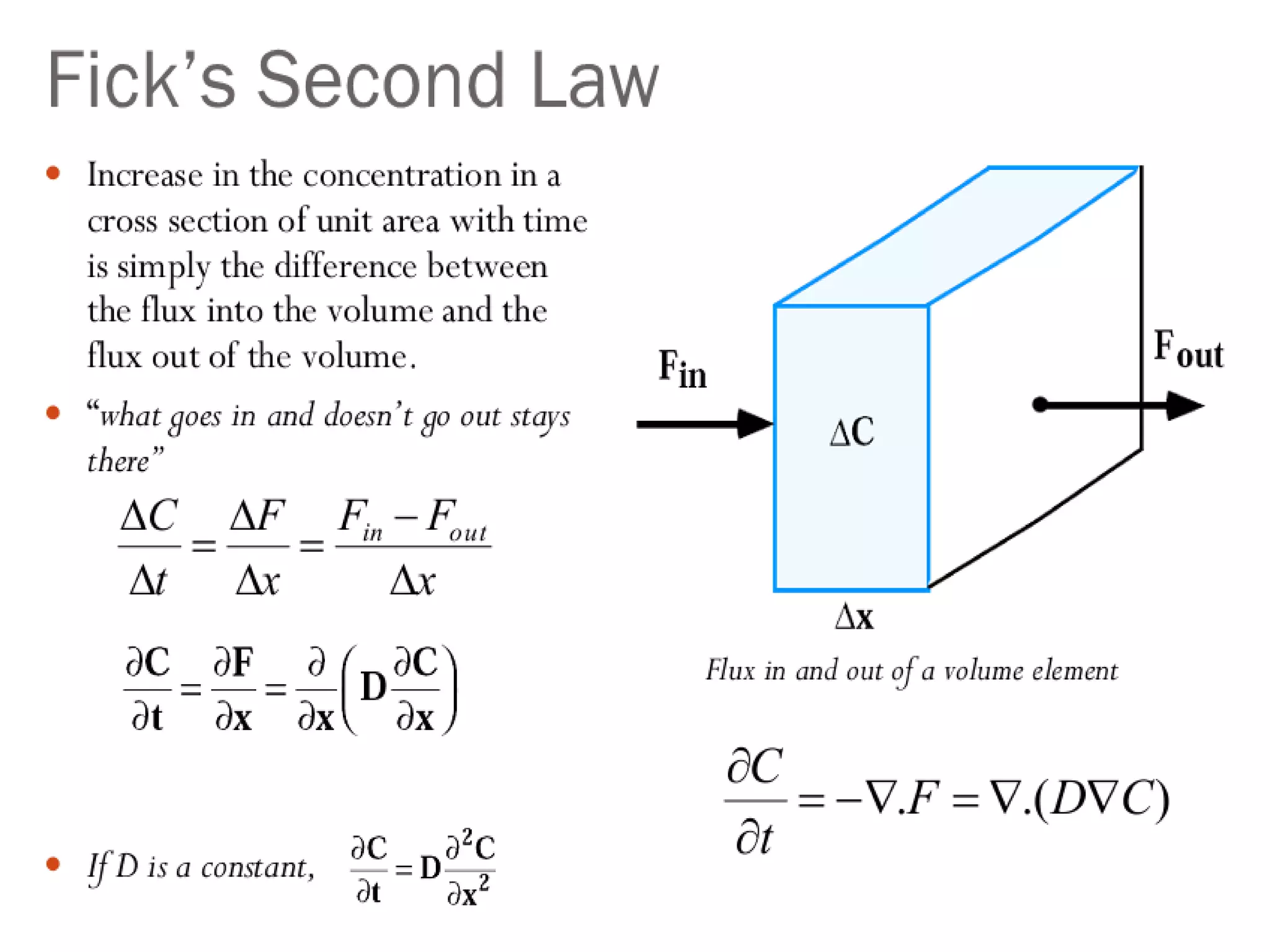

    Dopant Diffusion t1 t2 ConcentrationF=-DdC/dx Distance Concentration • Macroscopic dopant redistribution is described by Fick’s first law, which describes how the flux (or flow) of dopant depends on the concentration gradient. F =−D ∂C ∂x (4)
  • 19.
    Analytical Solution ofFick’s Law ( ) ( ) ( ) ( ) constQdxtxctc dxt0,dc0,xxc ===∞ =≠= ∫ ∞ ,,0, ,0/00, The solution to Fick’s Second Law for these conditions is a Gaussian centered at x =0 Gaussian solution in infinite medium: Consider a fixed dose Q introduced as Delta function at the origin: Drive in (7)
  • 21.
    2. Gaussian Solution: Constant Source Near A Surface: Analytic Solutions of Fick’s Laws • This is similar to the previous case except the diffusion only goes in one direction. • Dopant dose Q introduced at the surface. • Can be treated as an effective dose of 2Q being introduced in a virtual infinite medium. DeltaFunction DoseQ (Initial Profile) Imaginary DeltaFunction DoseQ Diffused Gaussian Virtual Diffusion x 0 (8)
  • 22.
    Analytic Solutions ofFick’s Laws 3.Error Function Solution : Infinite Source: • The infinite source is made up of small slices each diffusing as a Gaussian. C x,t( )= C 2 πDt ∆xi exp− x −xi( ) 2 4Dti=1 n ∑ (9) • The solution which satisfies Fick’s second law is C(x,t) = C 2 1−erf x 2 Dt            =CS erfc x 2 Dt             (10) C ² x Dose C² x Initial Profile Diffused Profile xi x 0 Dose CΔx Δx Boundary conditions: C=0 at t=0 for x> 0 C=C at t=0 for x< 0
  • 23.
    Analytic Solutions ofFick’s Laws Important consequences of error function solution: • Symmetry about mid-point allows solution for constant surface concentration to be derived. • Error function solution is made up of a sum of Gaussian delta function solutions. • Dose beyond x = 0 continues to increase with annealing time. . 0 0.2 0.4 0.6 0.8 1 -5 -4 -3 -2 -1 0 1 2 3 4 5 t=9*t 0 t=4*t 0 Initial t=t 0 erf(x/2¦Dt) X(Unitsof2¦Dt 0 )
  • 24.
    Analytic Solutions ofFick’s Laws 4. Error Function Solution: Constant Surface Concentration: • Just the right hand side of the figure on previous slide C x,t( )=CS erfc x 2 Dt       (11) • Note that the dose is given by Q = CS 0 ∞ ∫ 1−erf x 2 Dt            = 2CS π Dt (12) • Diffusion through Gas ambient
  • 25.
    Intrinsic Dopant DiffusionCoefficients • Intrinsic dopant diffusion coefficients are found to be of the form: D =D0 exp −EA kT       (13) Si B In As Sb P Units D0 560 1.0 1.2 9.17 4.58 4.70 cm2 sec-1 EA 4.76 3.5 3.5 3.99 3.88 3.68 eV • Note that ni is very large at process temperatures, so "intrinsic" actually applies under many conditions. • Note the "slow" and "fast" diffusers. Solubility is also an issue in choosing a particular dopant.
  • 26.
    Effect of SuccessiveDiffusions • If a dopant is diffused at temperature T1 for time t1 and then is diffused at temperature T2 for time t2, the total effective Dt is given by the sum of all the individual Dt products. Dteff =Dt =D1∑ t1 +D2t2 +..... (14) • The Gaussian solution only holds if the Dt used to introduce the dopant is small compared with the final Dt for the drive-in; i.e. if an initial delta function approximation is reasonable.
  • 27.
    Design of DiffusedLayers • Eqn. (3) has been numerically integrated for specific cases (erfc and Gaussian). • Example of Irvin’s curves, in this case for P type Gaussian profiles. 1 10 100 Effective Conductivity (ohm-cm)-1 SurfaceConcentration(cm-3) CB=1015 CB=1017 CB=1014 CB=1016 CB=1018 1020 1019 1018 1017
  • 28.
    Design of DiffusedLayers • We can now consider how to design a boron diffusion process (say for the well or tub of a CMOS process), such that: P P WellN Well ρS =900 Ω/square xj =3 µm NBC =1x1015 cm-3 (substrate concentration)
  • 29.
    Design of DiffusedLayers • The average conductivity of the layer is σ _ = 1 ρSxj = 1 (900Ω/sq)(3×10−4 cm) =3.7 Ω⋅cm( ) −1 • From Irvin’s curve we obtain CS ≈4×1017 /cm3 • We can surmise that the profile is Gaussian after drive-in. ∴CBC = Q πDt exp − xj 2 4Dt         =CS exp − xj 2 4Dt         so that Dt = Xj 2 4ln Cs Cbc = 3x10−4 ( ) 2 4ln 4x1017 1015       =3.7x10−9 cm2
  • 30.
    Design of DiffusedLayers • If the drive-in is done at 1100 ˚C, then the boron diffusivity is D =1.5×10−13 cm2 sec−1 • The drive-in time is therefore tdrive−in = 3.7×10−9 cm2 1.5×10−13 cm2 / sec =6.8 hours • Given both the surface concentration and Dt, the initial dose can be calculated for this Gaussian profile. Q =CS πDt =4×1017 ( )π()3.7×10−9 ( )=4.3×1013 cm−2 • This dose could easily be implanted in a narrow layer close to the surface, justifying the implicit assumption in the Gaussian profile that the initial distribution approximates a delta function.
  • 31.
    Design of DiffusedLayers • If a gas/solid phase predeposition step at 950˚C were used, then B solid solubility at 950 ˚C is B diffusivity is 2.5×1020 cm−3 4.2×10−15 cm2 sec−1{ • The dose for an erfc profile is Q = 2Cs π Dt • So that the time required for the predeposition is tpre−dep = 4.3×1013 2.5×1020       2 π 2       2 1 4.2×10−15 =5.5sec Check: ( ) ( )914 107.3103.2 − − − ×<<× indrivepredep DtDt
  • 32.
    Four Point Probe: Characterization Whent << s, as in the case of diffused or implanted layer, Sheet Resistance Resistivity=
  • 34.

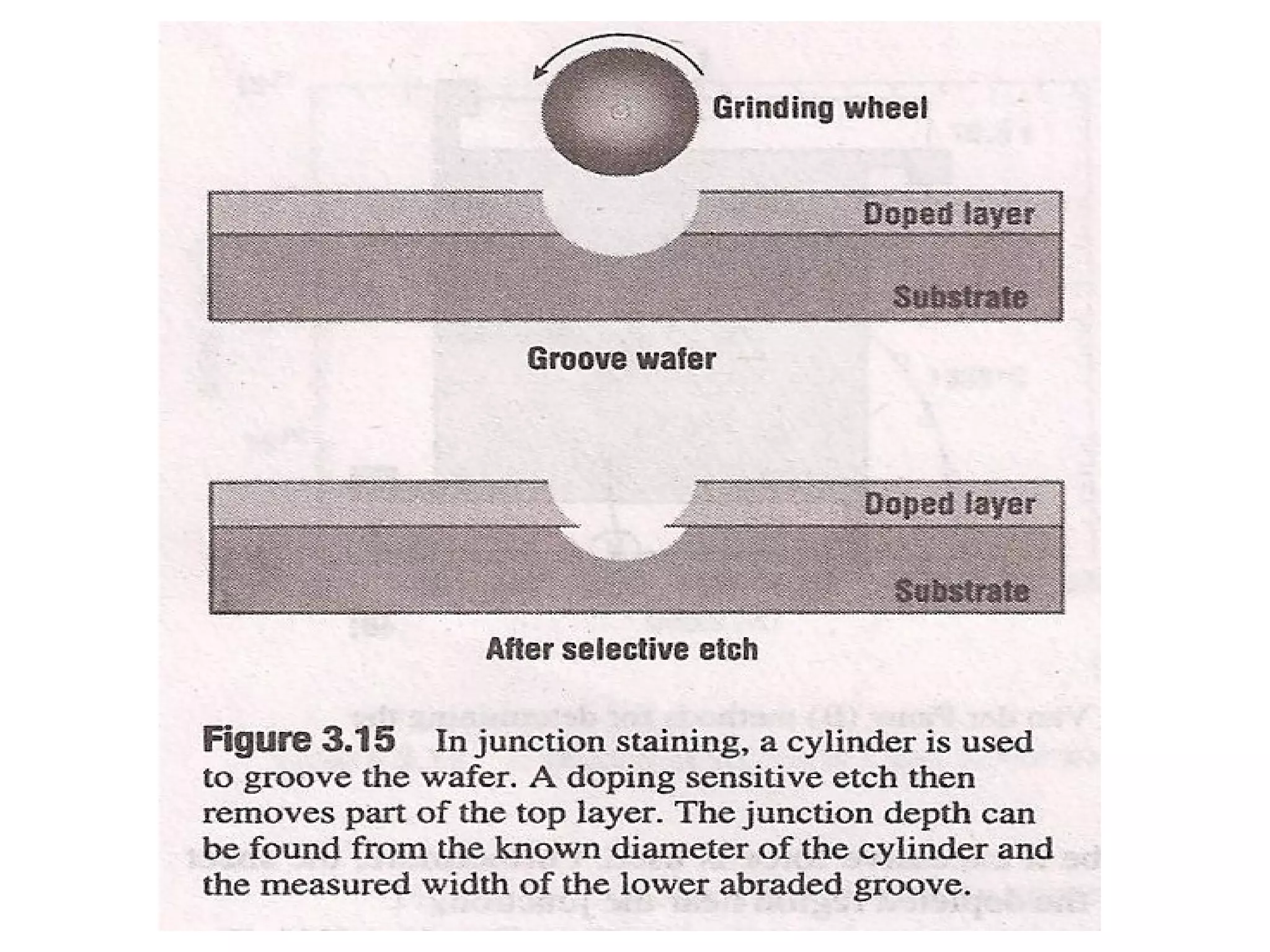

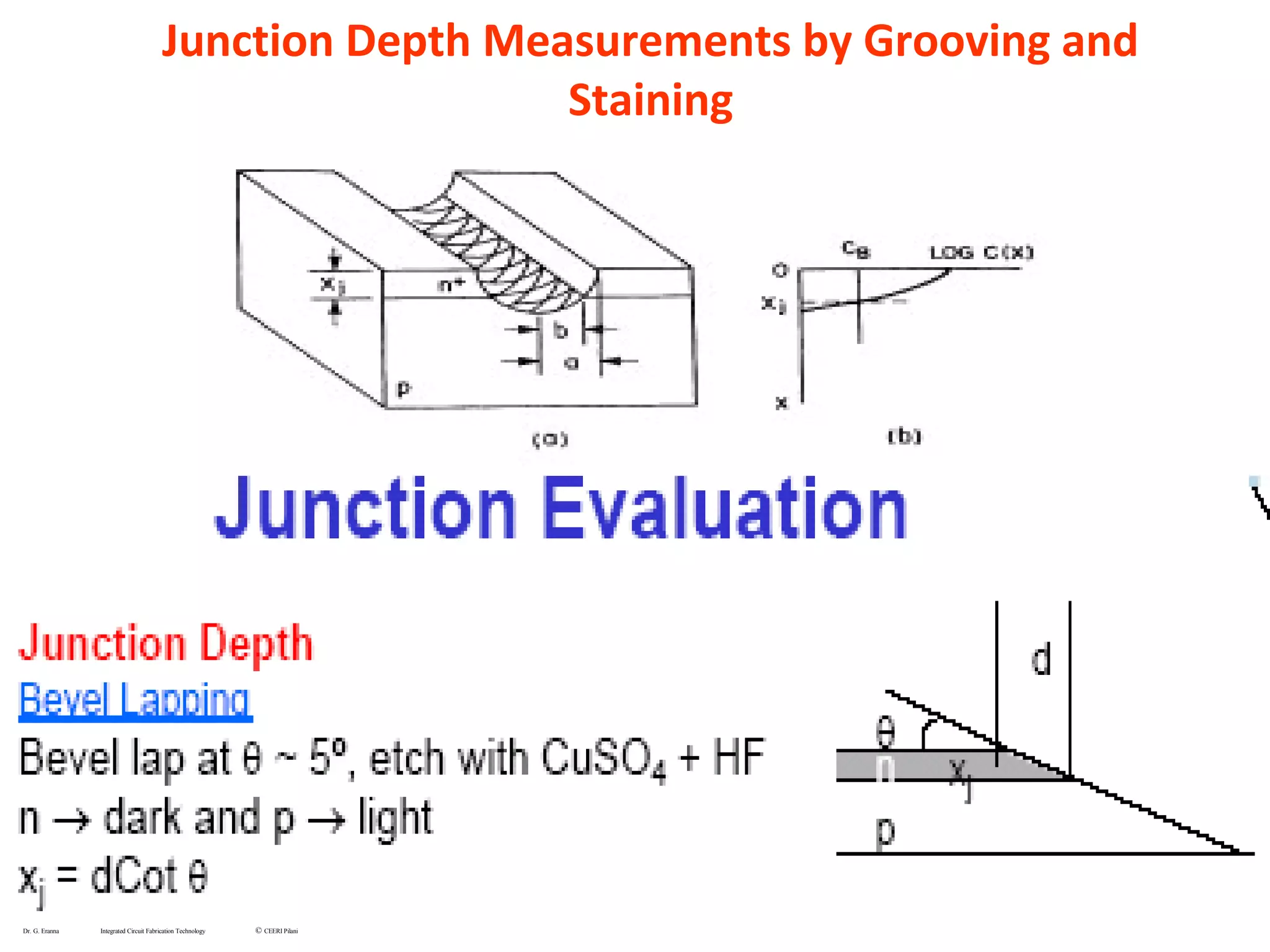

    Dr. G. ErannaIntegrated Circuit Fabrication Technology © CEERI Pilani Junction Depth Measurements by Grooving and Staining
  • 35.
    Spreading Resistance Technique toGet Impurity Profiles within Transistor Regions (Destructive Technique) Dr. G. Eranna Integrated Circuit Fabrication Technology © CEERI Pilani
