SELF-ASSESSMENT OF ORGANIZATIONAL
CAPACITY IN MONITORING & EVALUATION
                  by
   SNNP REGIONAL HEALTH BUREAU
 SIDAMA ZONAL HEALTH DEPARTMENT

       PRESENTATION of FINDINGS

           05 December 2012

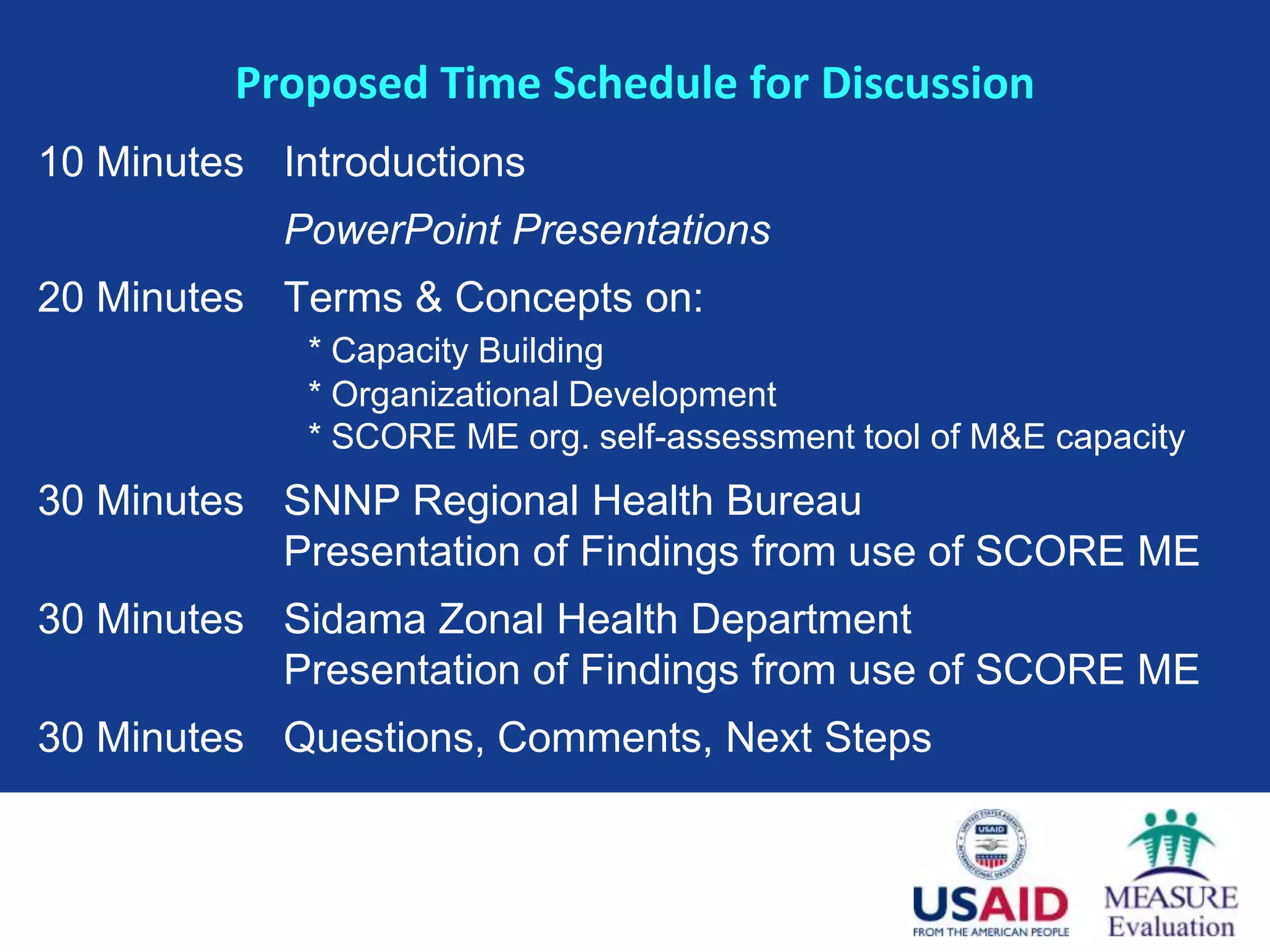

Proposed Time Schedule for Discussion
10 Minutes Introductions
            PowerPoint Presentations
20 Minutes Terms & Concepts on:
             * Capacity Building
             * Organizational Development
             * SCORE ME org. self-assessment tool of M&E capacity
30 Minutes SNNP Regional Health Bureau
           Presentation of Findings from use of SCORE ME
30 Minutes Sidama Zonal Health Department
           Presentation of Findings from use of SCORE ME
30 Minutes Questions, Comments, Next Steps

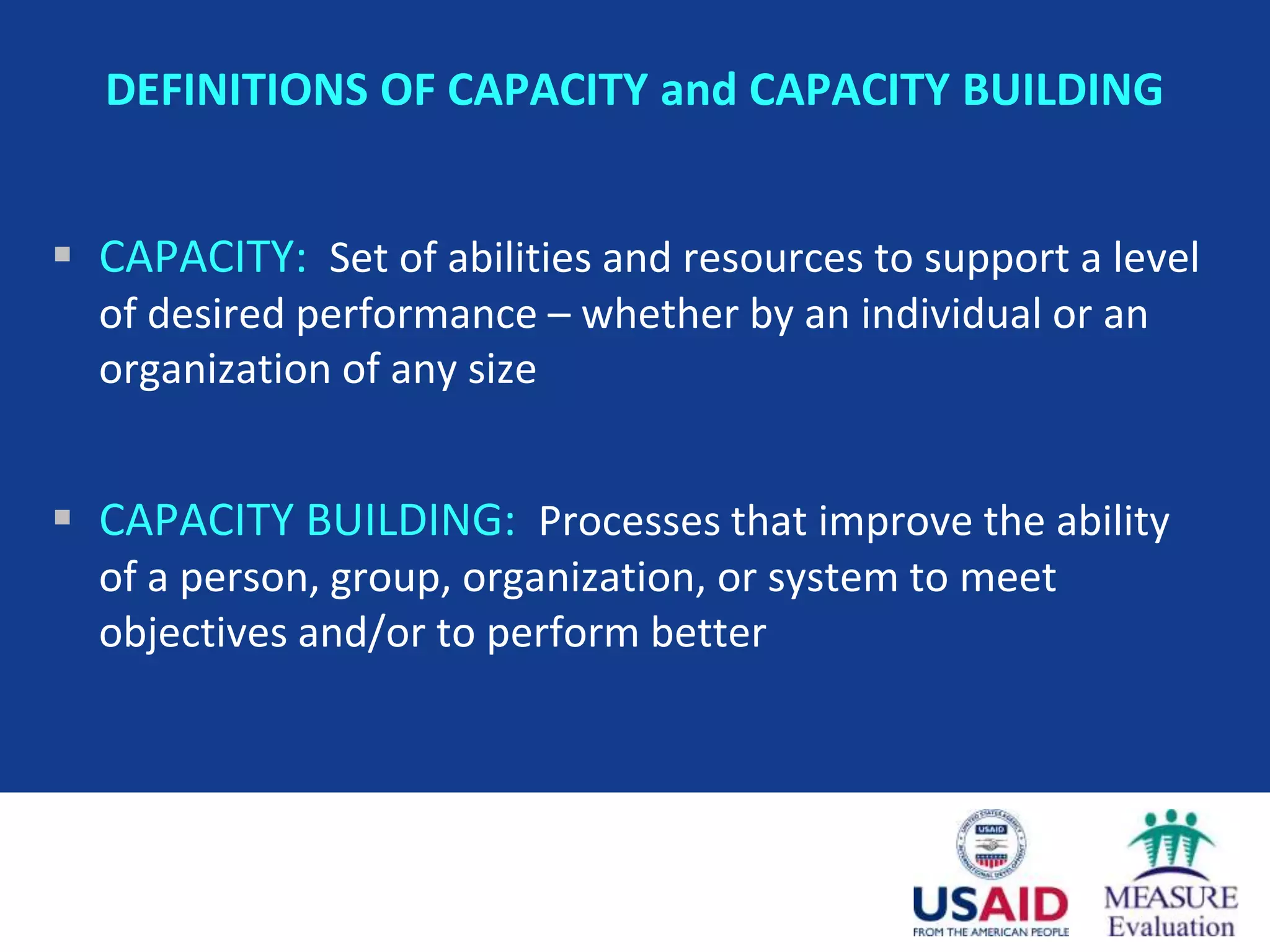

DEFINITIONS OF CAPACITY and CAPACITY BUILDING

 CAPACITY: Set of abilities and resources to support a level
  of desired performance – whether by an individual or an
  organization of any size

 CAPACITY BUILDING: Processes that improve the ability
  of a person, group, organization, or system to meet
  objectives and/or to perform better

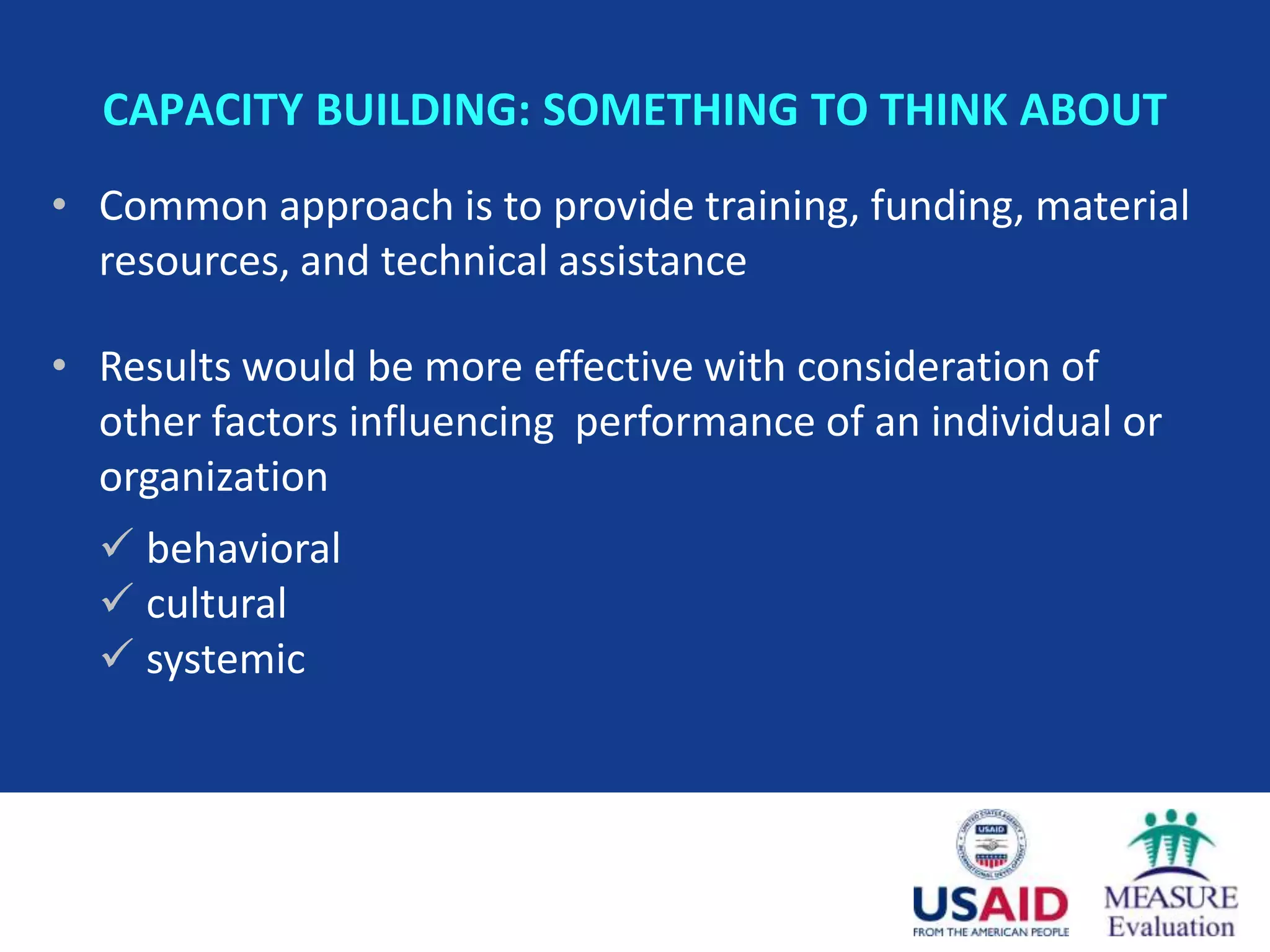

CAPACITY BUILDING: SOMETHING TO THINK ABOUT
• Common approach is to provide training, funding, material
  resources, and technical assistance

• Results would be more effective with consideration of
  other factors influencing performance of an individual or
  organization
   behavioral
   cultural
   systemic

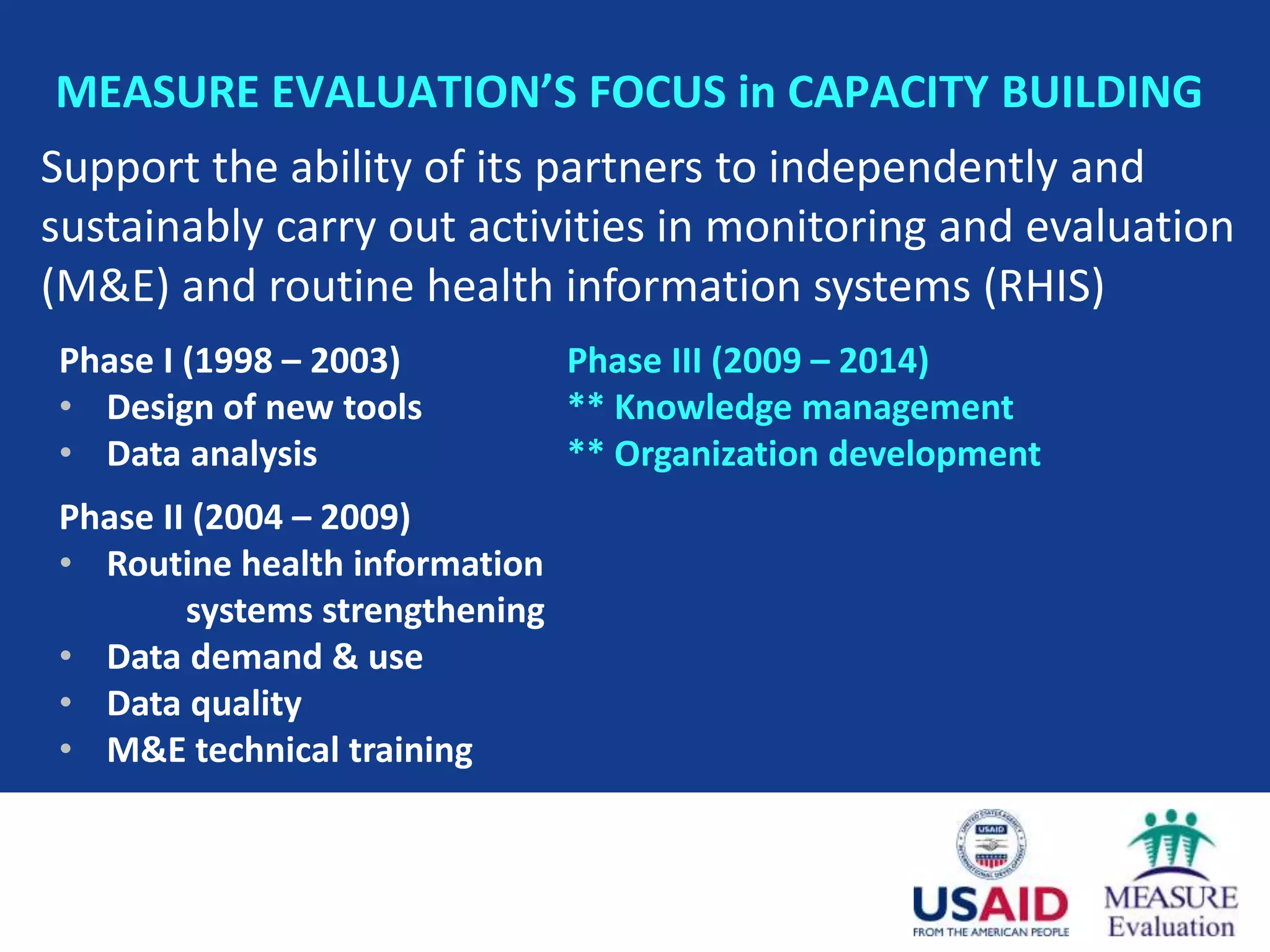

MEASURE EVALUATION’S FOCUS in CAPACITY BUILDING
Support the ability of its partners to independently and
sustainably carry out activities in monitoring and evaluation
(M&E) and routine health information systems (RHIS)
Phase I (1998 – 2003)           Phase III (2009 – 2014)
• Design of new tools           ** Knowledge management
• Data analysis                 ** Organization development
Phase II (2004 – 2009)
• Routine health information
        systems strengthening
• Data demand & use
• Data quality
• M&E technical training

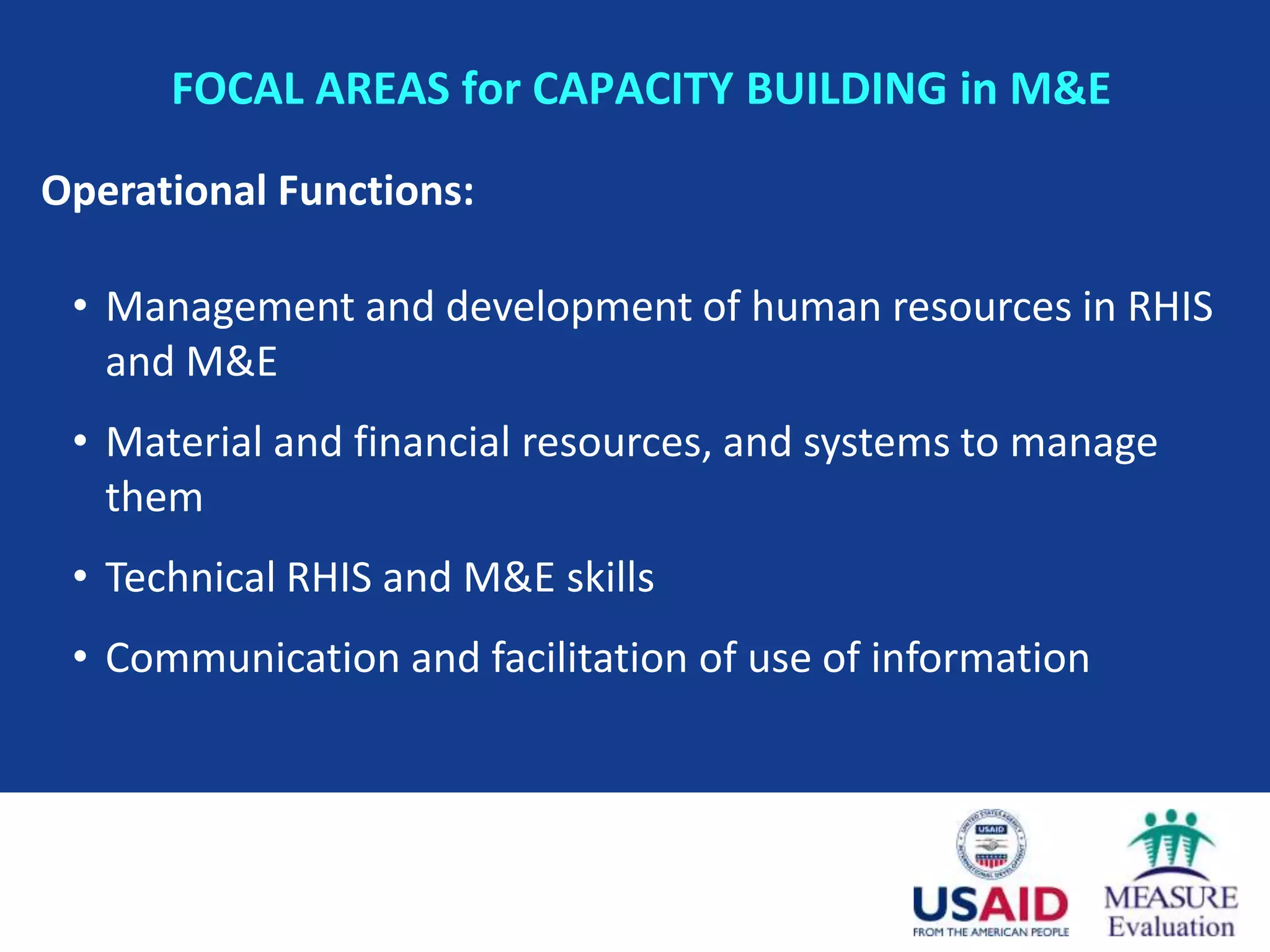

FOCAL AREAS for CAPACITY BUILDING in M&E

Operational Functions:

 • Management and development of human resources in RHIS
   and M&E
 • Material and financial resources, and systems to manage
   them
 • Technical RHIS and M&E skills
 • Communication and facilitation of use of information

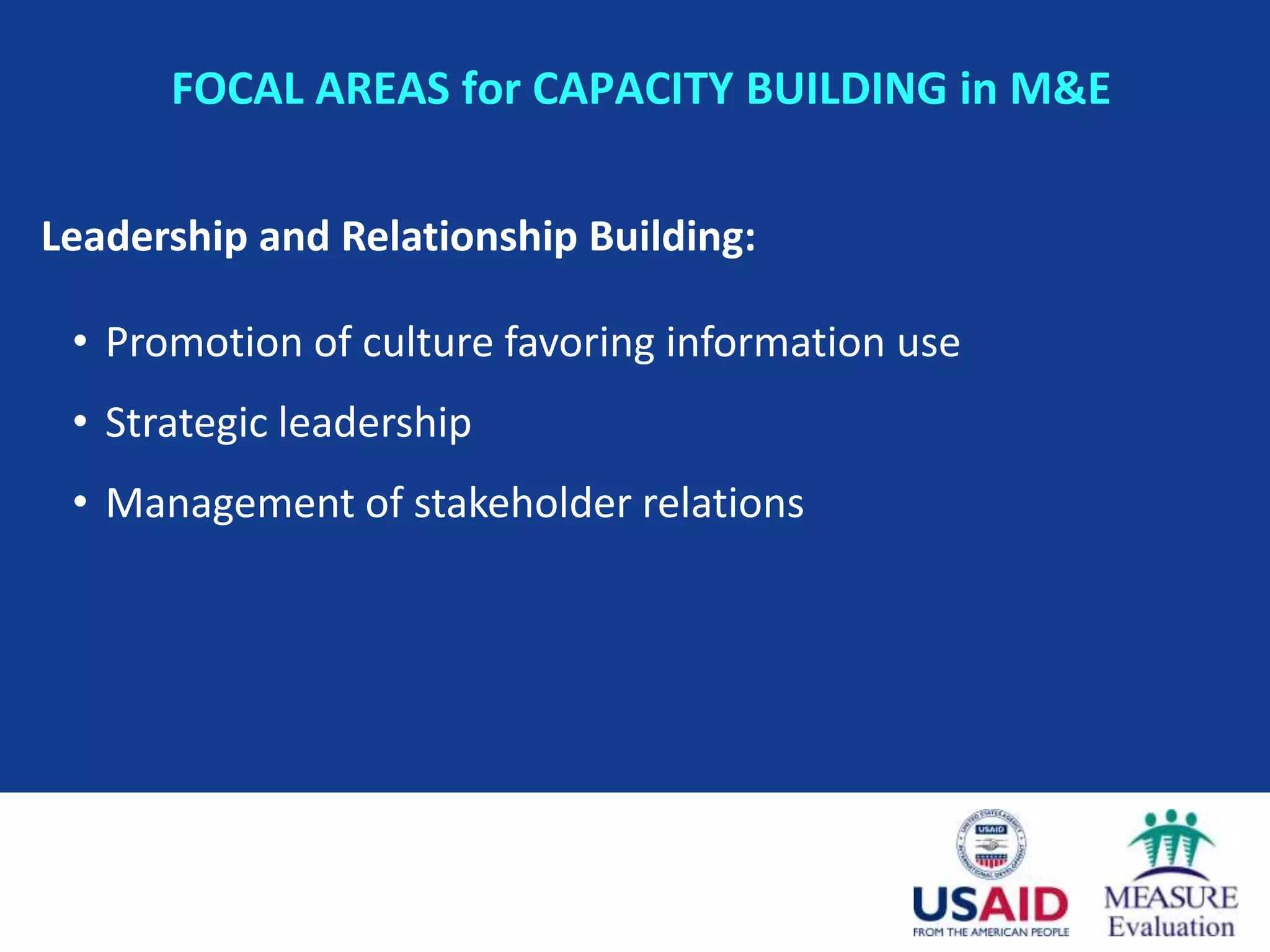

FOCAL AREAS for CAPACITY BUILDING in M&E

Leadership and Relationship Building:

 • Promotion of culture favoring information use
 • Strategic leadership
 • Management of stakeholder relations
MEASURE EVALUATION’s CONCEPT of

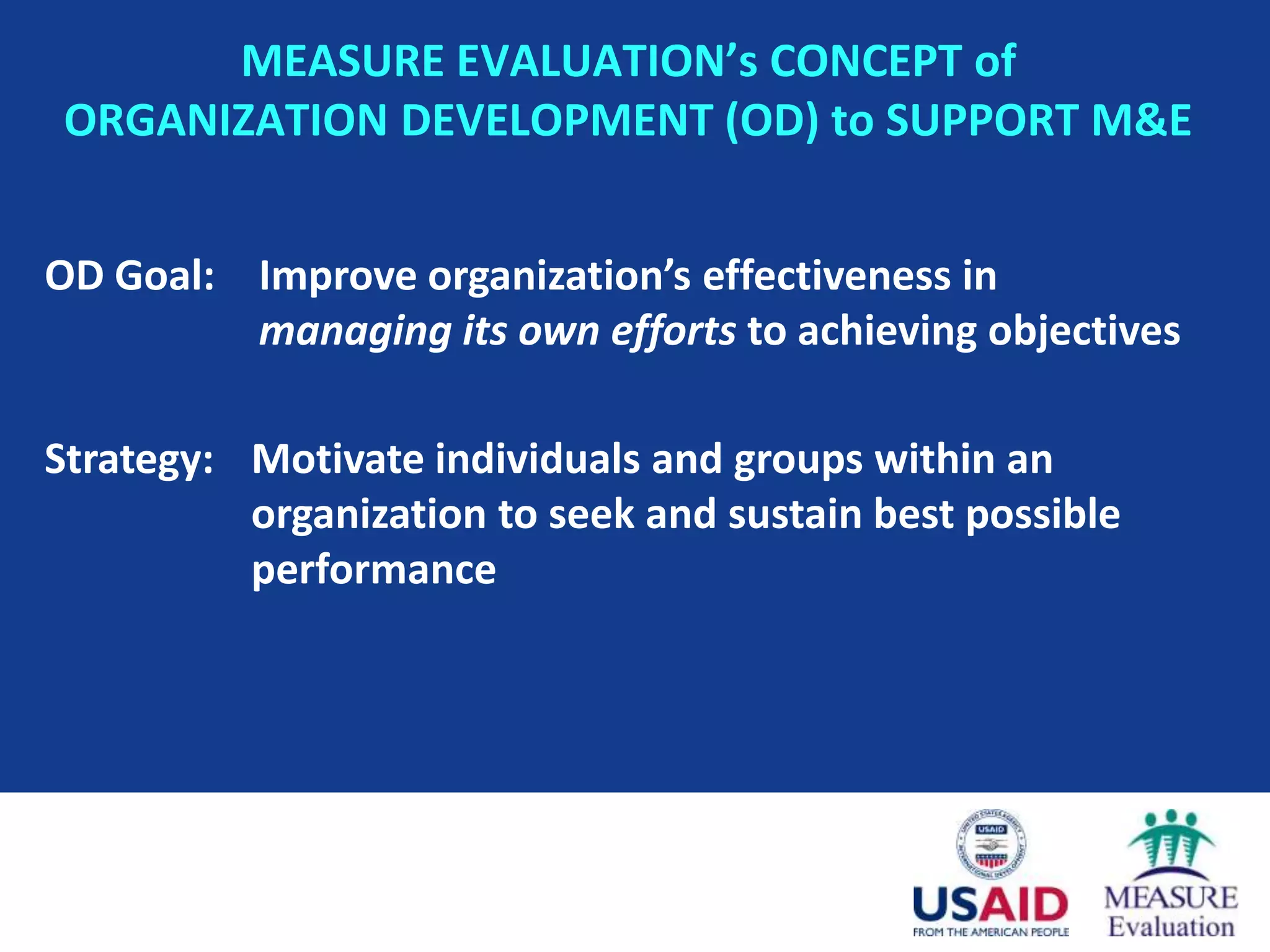

 ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E

OD Goal: Improve organization’s effectiveness in
         managing its own efforts to achieving objectives

Strategy: Motivate individuals and groups within an
          organization to seek and sustain best possible
          performance
MEASURE EVALUATION’s CONCEPT of
ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E

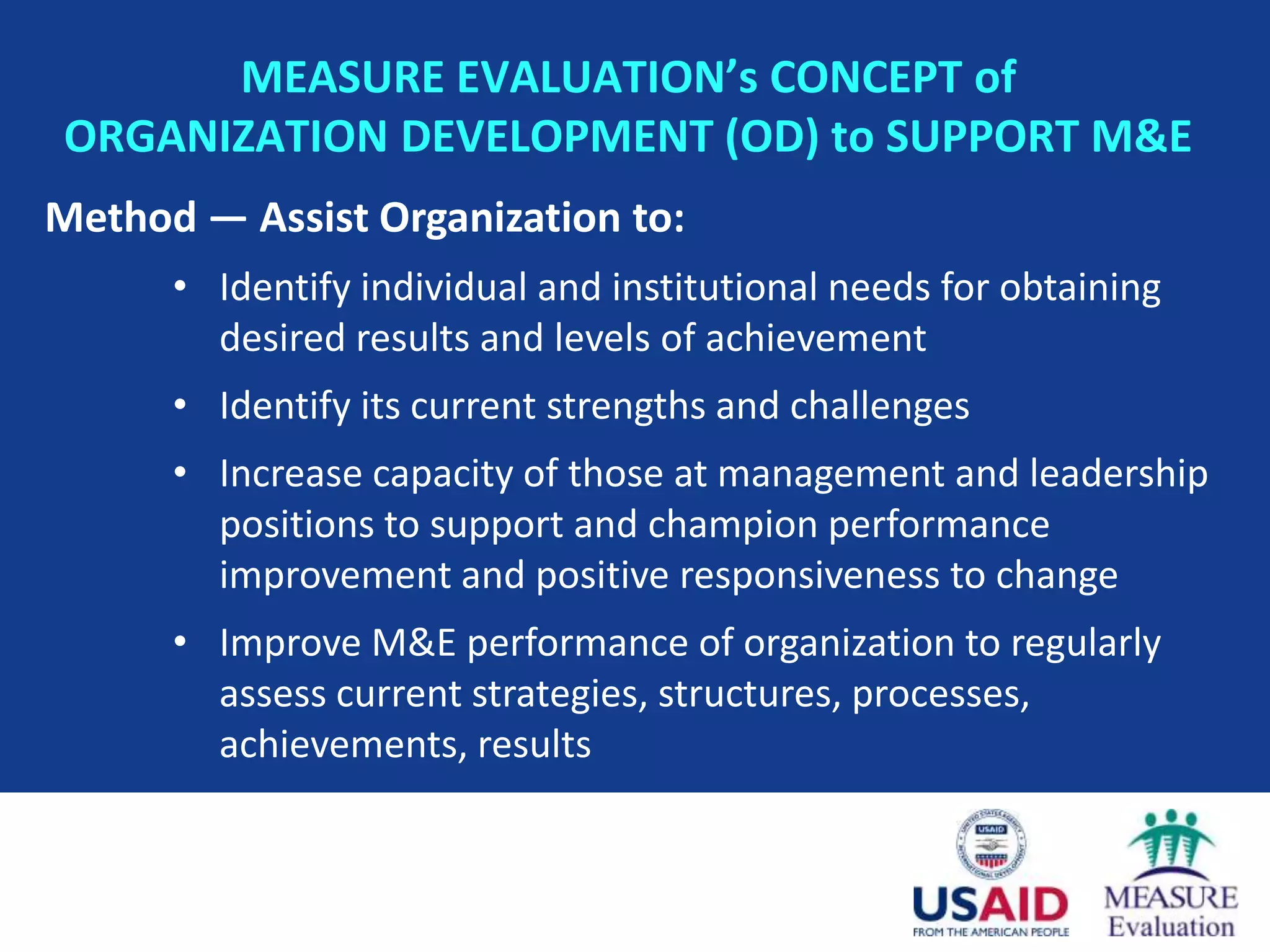

Method — Assist Organization to:
      • Identify individual and institutional needs for obtaining
        desired results and levels of achievement
      • Identify its current strengths and challenges
      • Increase capacity of those at management and leadership
        positions to support and champion performance
        improvement and positive responsiveness to change
      • Improve M&E performance of organization to regularly
        assess current strategies, structures, processes,
        achievements, results
MEASURE EVALUATION’s CONCEPT of
ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E

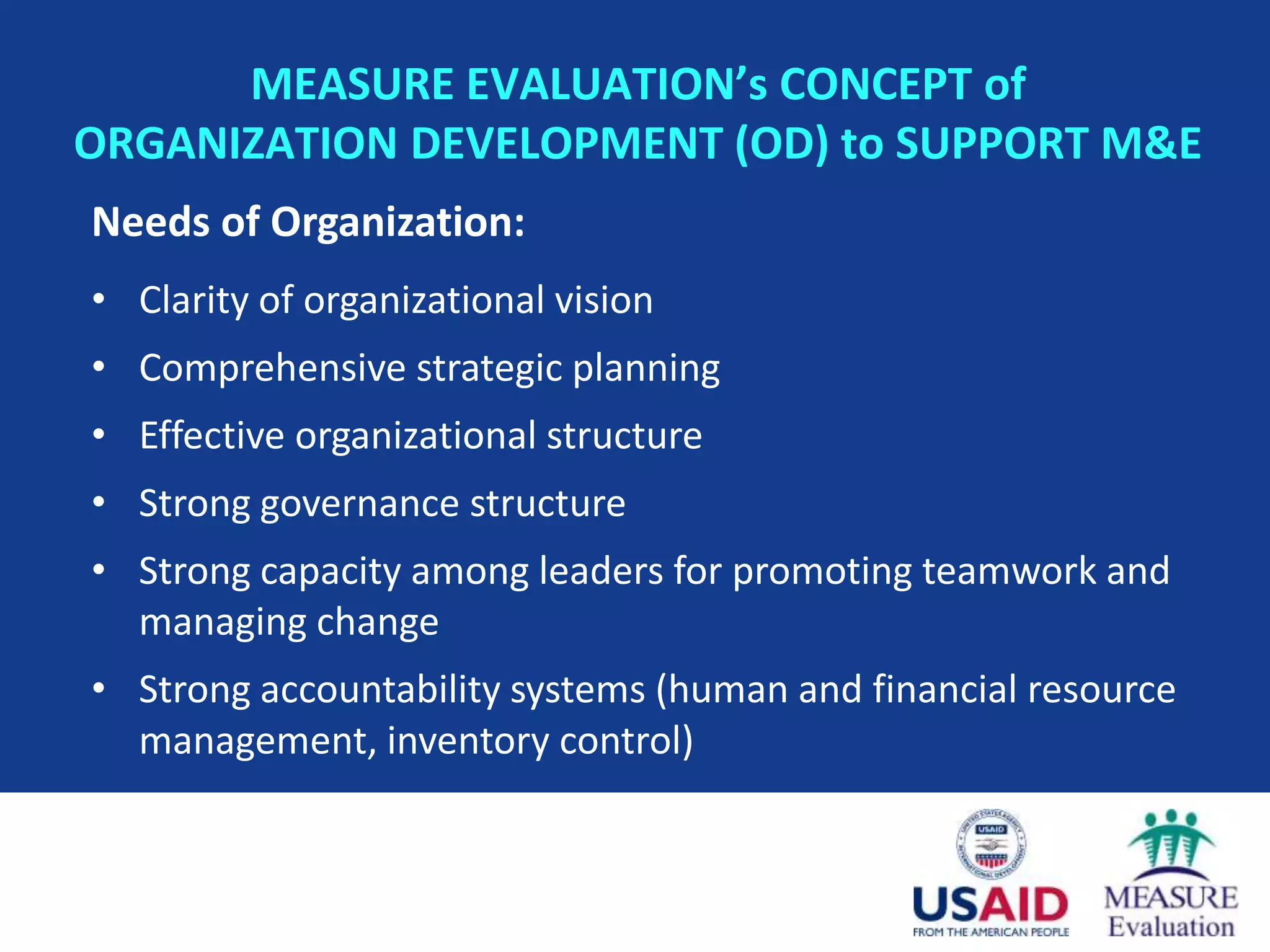

Needs of Organization:
• Clarity of organizational vision
• Comprehensive strategic planning
• Effective organizational structure
• Strong governance structure
• Strong capacity among leaders for promoting teamwork and
  managing change
• Strong accountability systems (human and financial resource
  management, inventory control)
MEASURE EVALUATION’s CONCEPT of

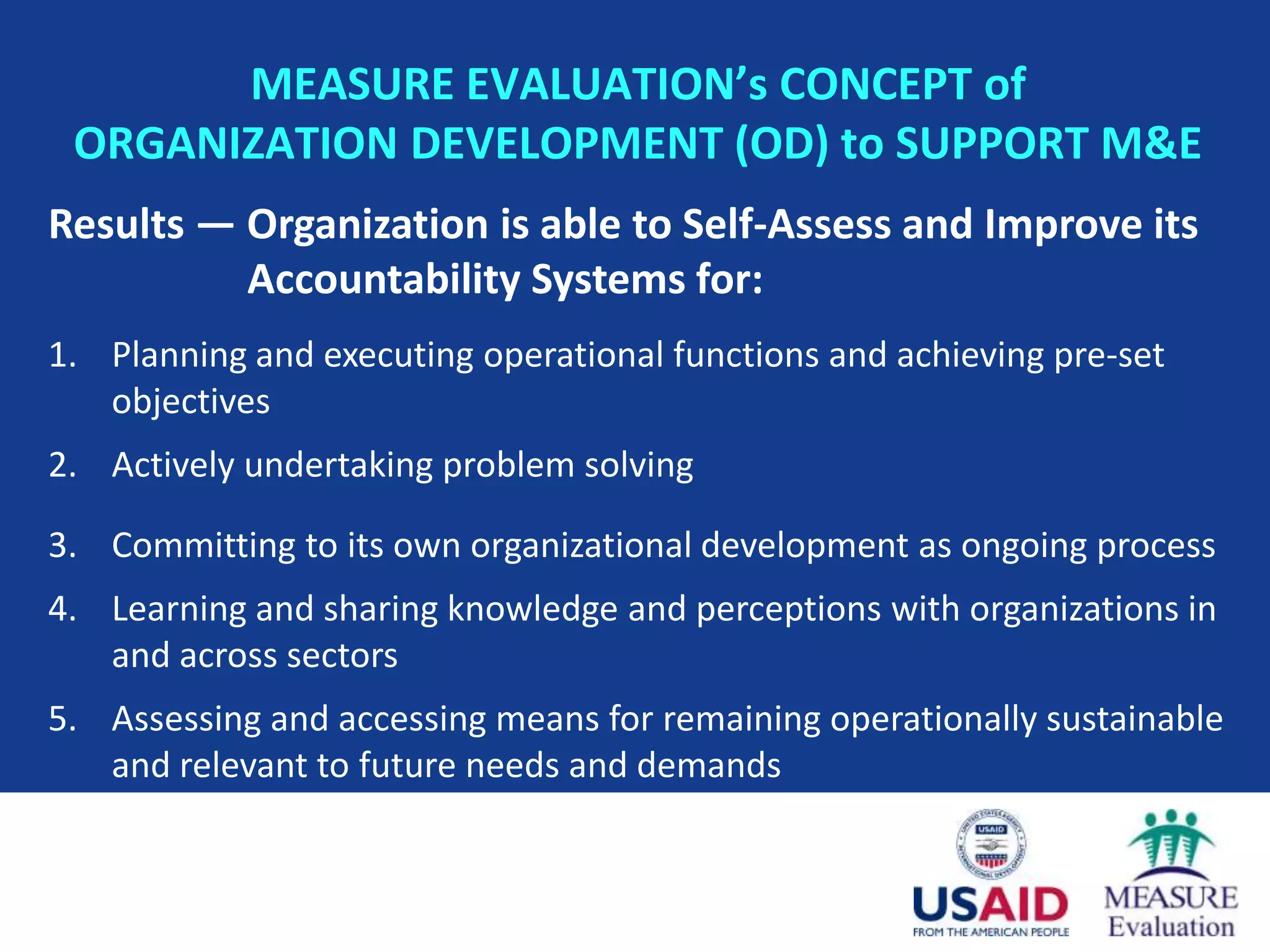

 ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E
Results — Organization is able to Self-Assess and Improve its
          Accountability Systems for:
1. Planning and executing operational functions and achieving pre-set
   objectives
2. Actively undertaking problem solving

3. Committing to its own organizational development as ongoing process
4. Learning and sharing knowledge and perceptions with organizations in
   and across sectors
5. Assessing and accessing means for remaining operationally sustainable
   and relevant to future needs and demands

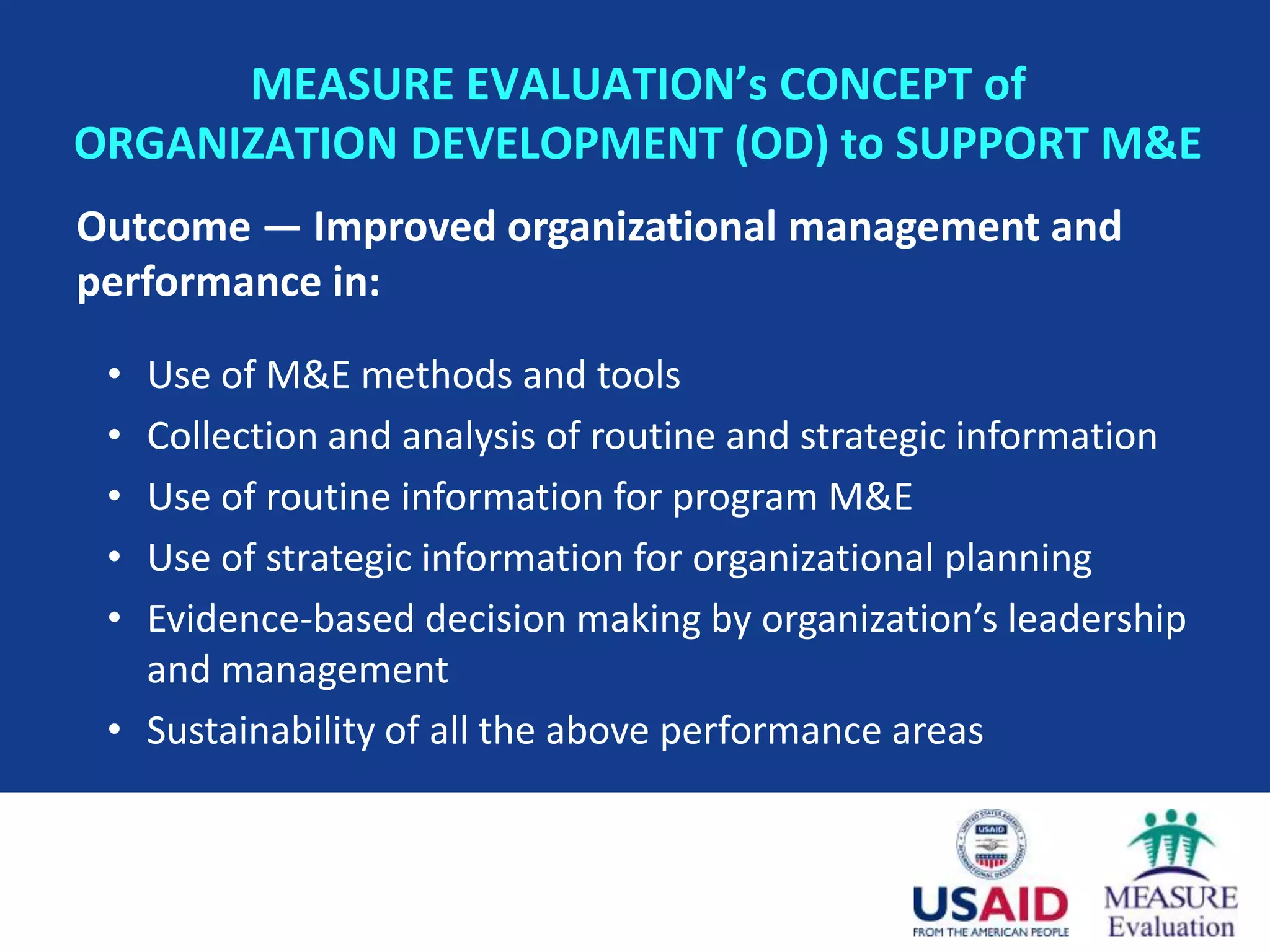

MEASURE EVALUATION’s CONCEPT of
ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E
Outcome — Improved organizational management and
performance in:

 • Use of M&E methods and tools
 • Collection and analysis of routine and strategic information
 • Use of routine information for program M&E
 • Use of strategic information for organizational planning
 • Evidence-based decision making by organization’s leadership
   and management
 • Sustainability of all the above performance areas
Self-Assessment of
Capacity regarding
Organization’s
Response in
M&E

   SCORE ME

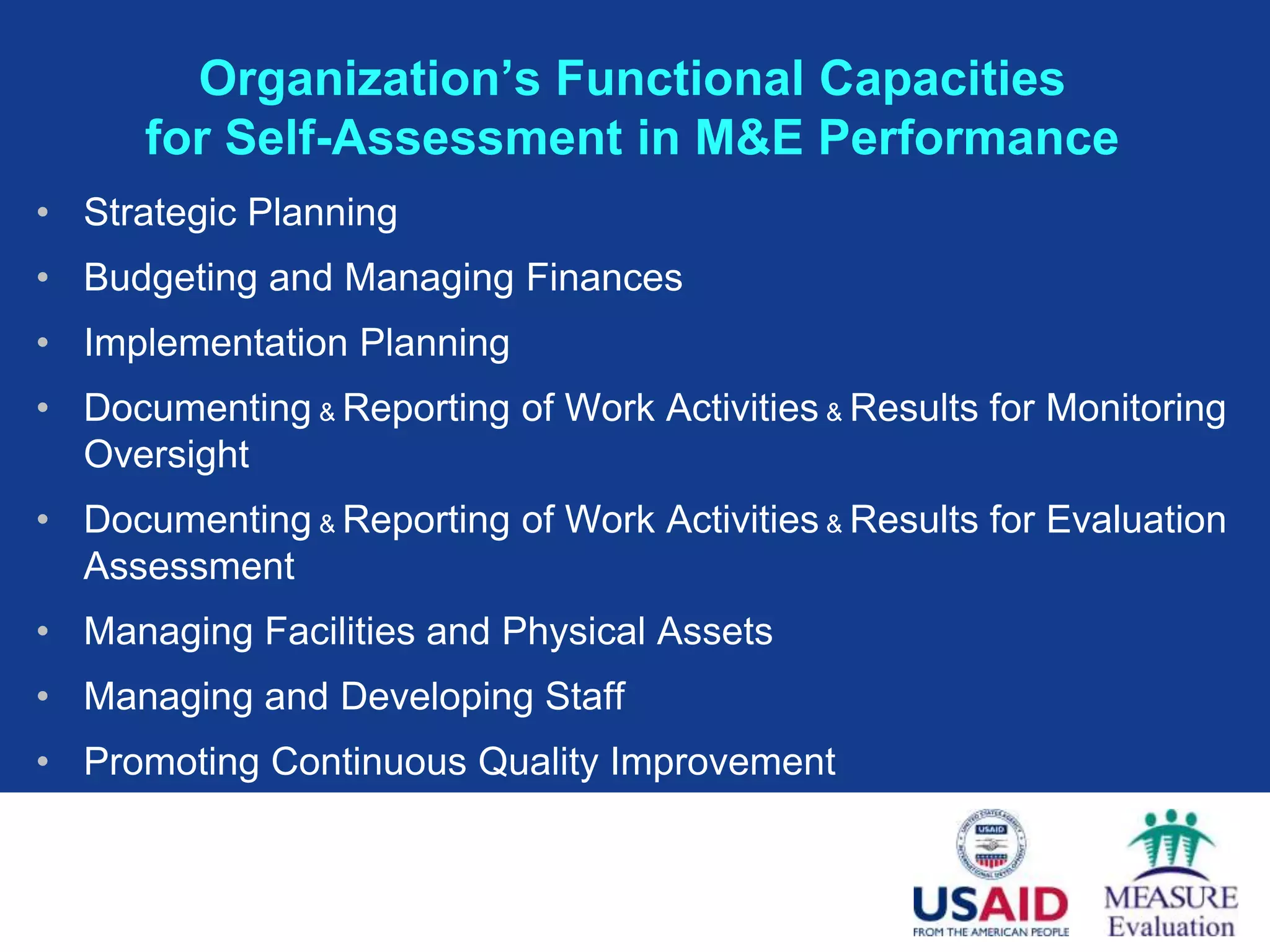

Organization’s Functional Capacities
      for Self-Assessment in M&E Performance
• Strategic Planning
• Budgeting and Managing Finances
• Implementation Planning
• Documenting & Reporting of Work Activities & Results for Monitoring
  Oversight
• Documenting & Reporting of Work Activities & Results for Evaluation
  Assessment
• Managing Facilities and Physical Assets
• Managing and Developing Staff
• Promoting Continuous Quality Improvement

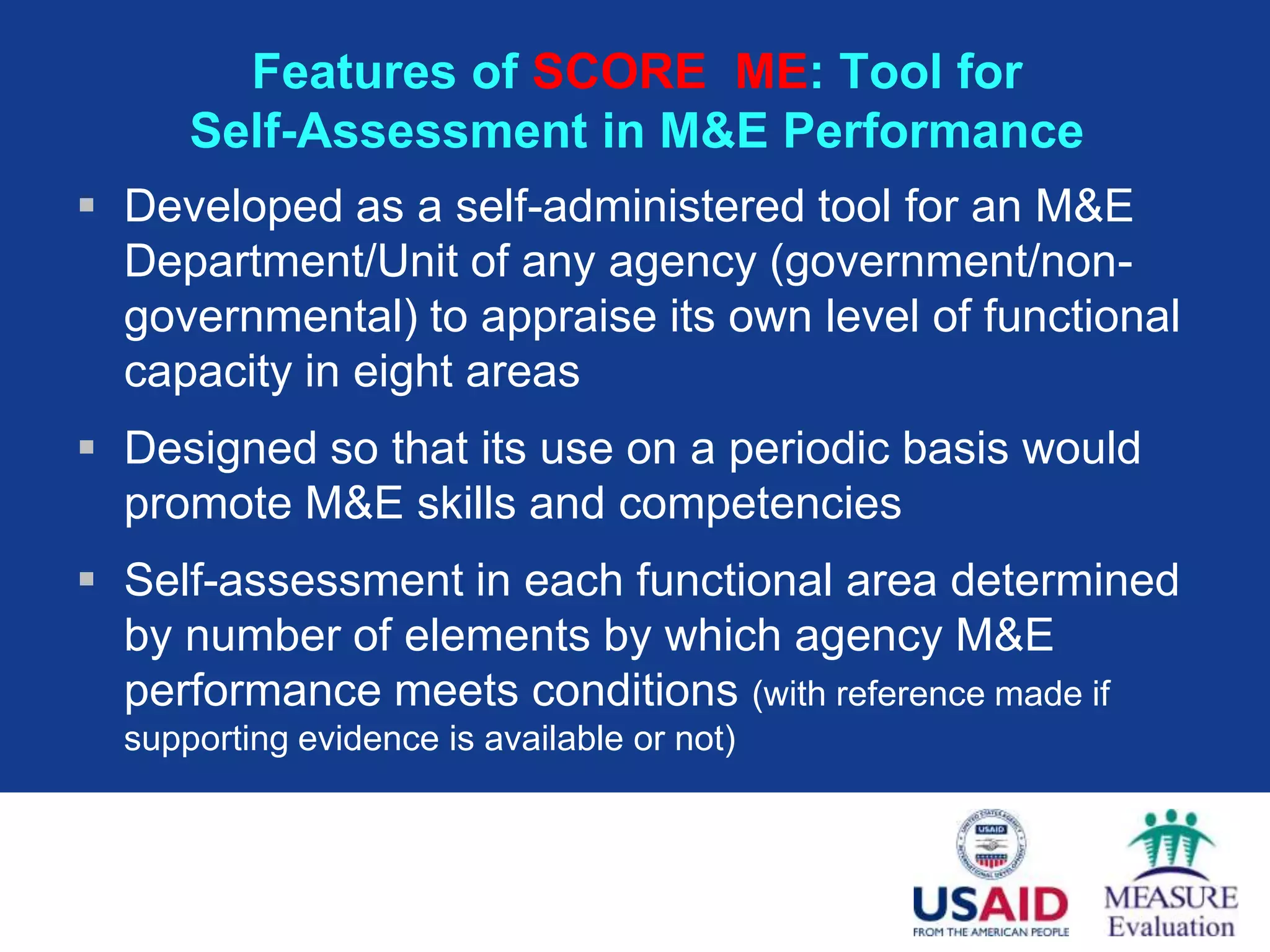

Features of SCORE ME: Tool for
      Self-Assessment in M&E Performance
 Developed as a self-administered tool for an M&E
  Department/Unit of any agency (government/non-
  governmental) to appraise its own level of functional
  capacity in eight areas
 Designed so that its use on a periodic basis would
  promote M&E skills and competencies
 Self-assessment in each functional area determined
  by number of elements by which agency M&E
  performance meets conditions (with reference made if
  supporting evidence is available or not)

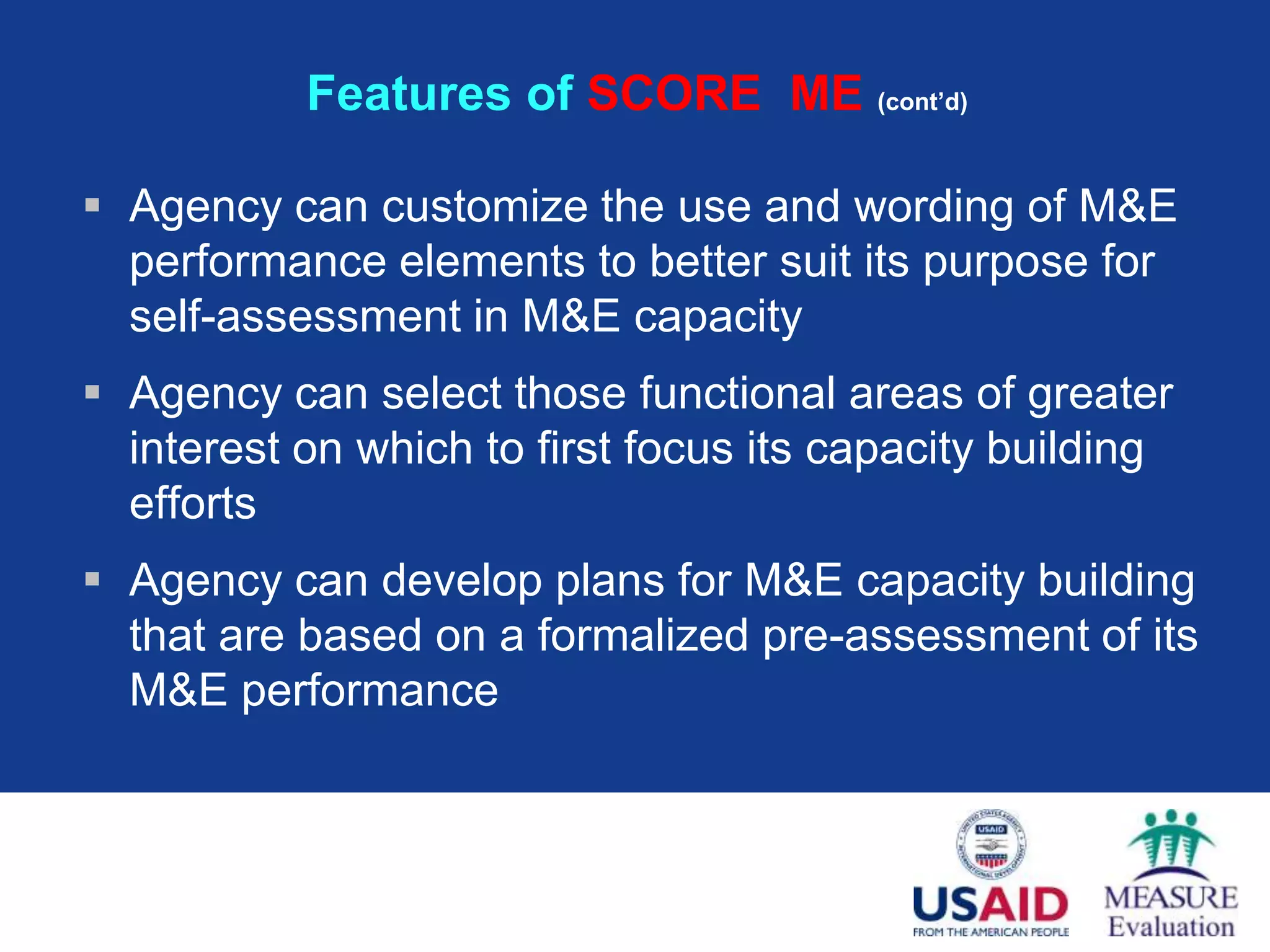

Features of SCORE ME (cont’d)

 Agency can customize the use and wording of M&E
  performance elements to better suit its purpose for
  self-assessment in M&E capacity
 Agency can select those functional areas of greater
  interest on which to first focus its capacity building
  efforts
 Agency can develop plans for M&E capacity building
  that are based on a formalized pre-assessment of its
  M&E performance
Introduction of SCORE ME to
          Health Sectors in SNNP Region

• Review of content and use of SCORE ME instrument

• Organizational and individual self-assessments of M&E
  capacity, with on-site technical assistance, as required

• Formulation of improvement plan for organizational
  capacity in M&E, as based on self-assessment findings

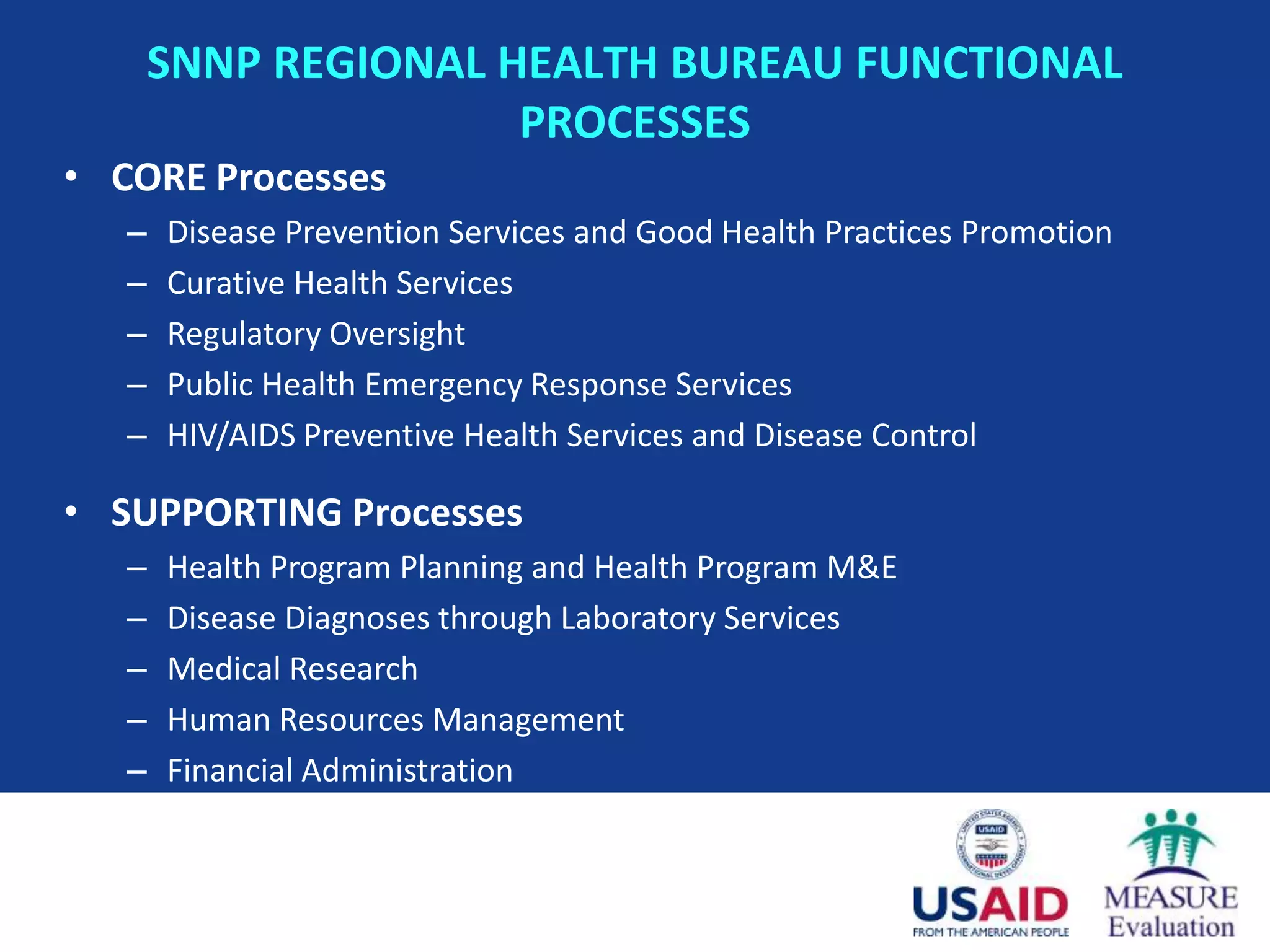

SNNP REGIONAL HEALTH BUREAU FUNCTIONAL
                      PROCESSES
• CORE Processes
   –   Disease Prevention Services and Good Health Practices Promotion
   –   Curative Health Services
   –   Regulatory Oversight
   –   Public Health Emergency Response Services
   –   HIV/AIDS Preventive Health Services and Disease Control

• SUPPORTING Processes
   –   Health Program Planning and Health Program M&E
   –   Disease Diagnoses through Laboratory Services
   –   Medical Research
   –   Human Resources Management
   –   Financial Administration

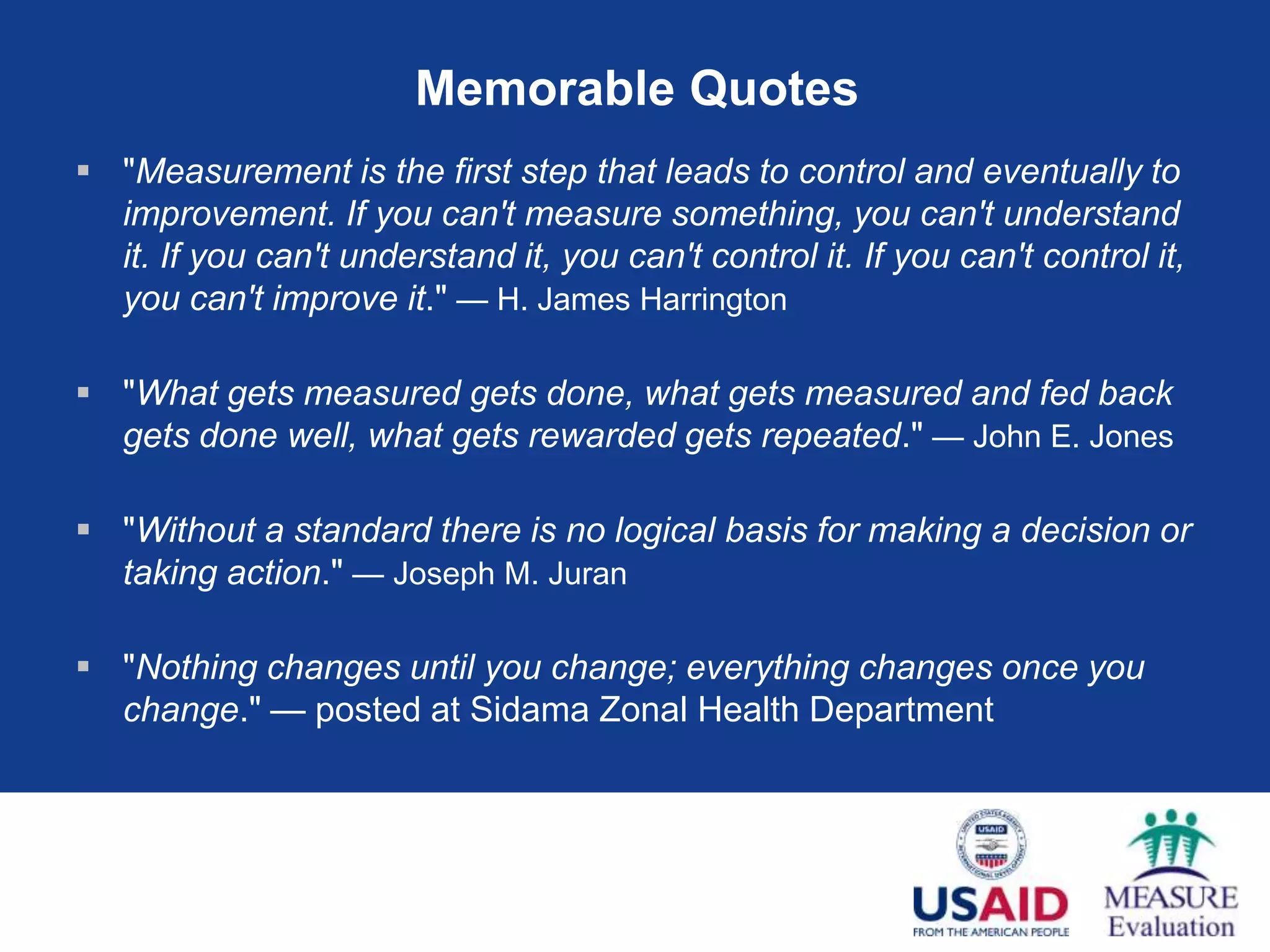

Memorable Quotes
 "Measurement is the first step that leads to control and eventually to
  improvement. If you can't measure something, you can't understand
  it. If you can't understand it, you can't control it. If you can't control it,
  you can't improve it." — H. James Harrington

 "What gets measured gets done, what gets measured and fed back
  gets done well, what gets rewarded gets repeated." — John E. Jones

 "Without a standard there is no logical basis for making a decision or
  taking action." — Joseph M. Juran

 "Nothing changes until you change; everything changes once you
  change." — posted at Sidama Zonal Health Department

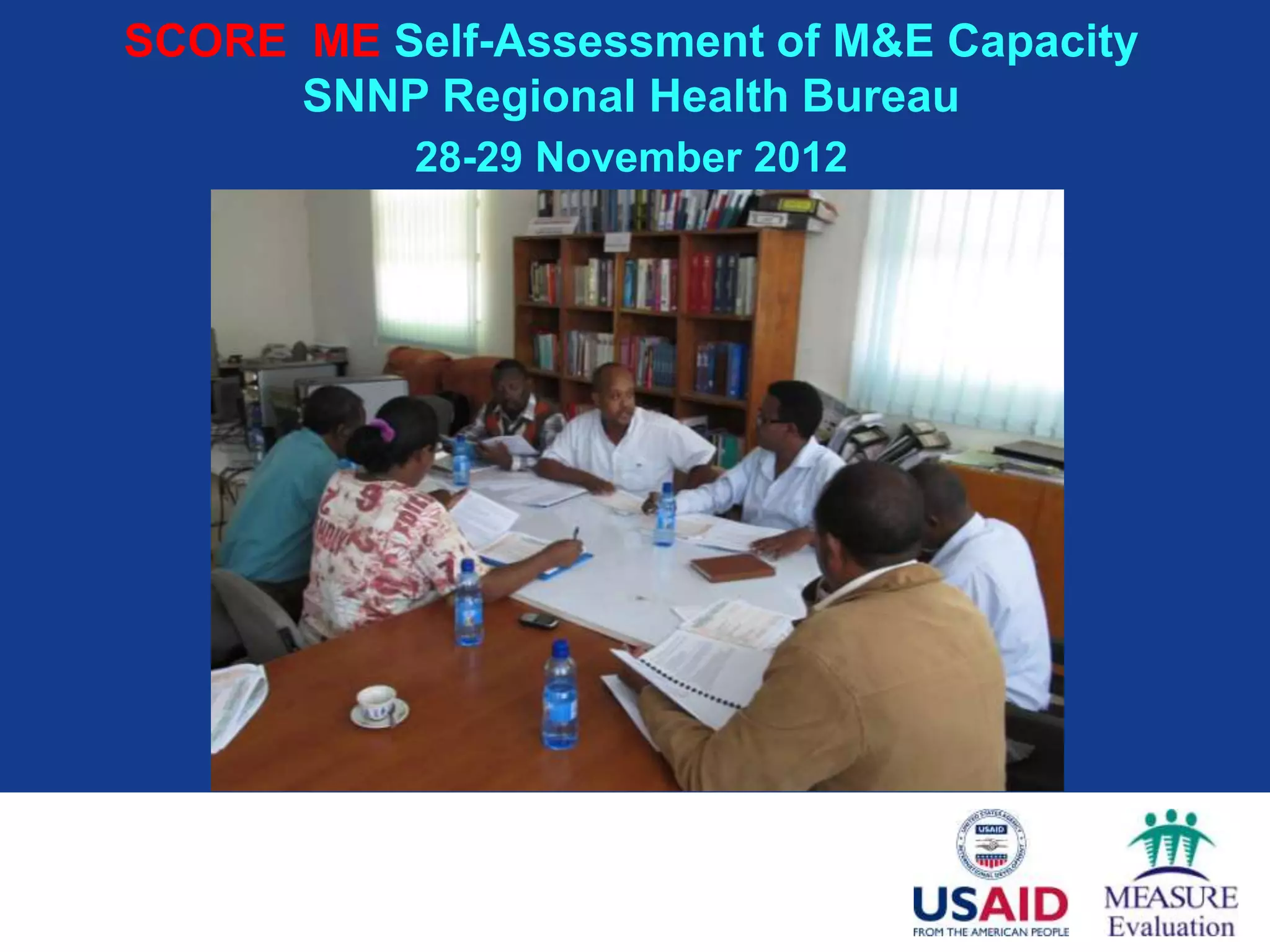

SCORE ME Self-Assessment of M&E Capacity
      SNNP Regional Health Bureau
           28-29 November 2012

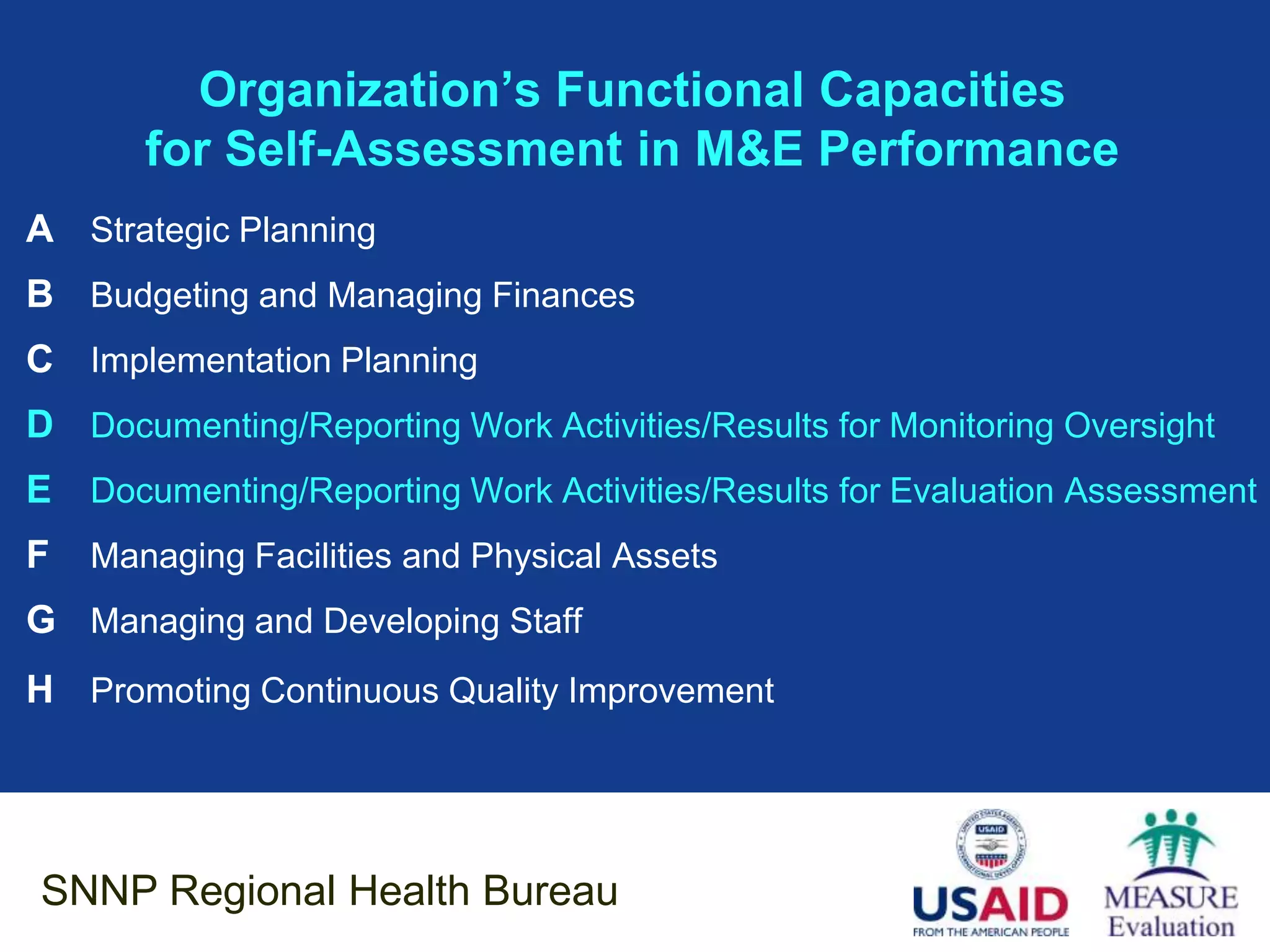

Organization’s Functional Capacities
       for Self-Assessment in M&E Performance
A Strategic Planning
B Budgeting and Managing Finances
C Implementation Planning
D Documenting/Reporting Work Activities/Results for Monitoring Oversight
E Documenting/Reporting Work Activities/Results for Evaluation Assessment
F   Managing Facilities and Physical Assets
G Managing and Developing Staff
H Promoting Continuous Quality Improvement

SNNP Regional Health Bureau

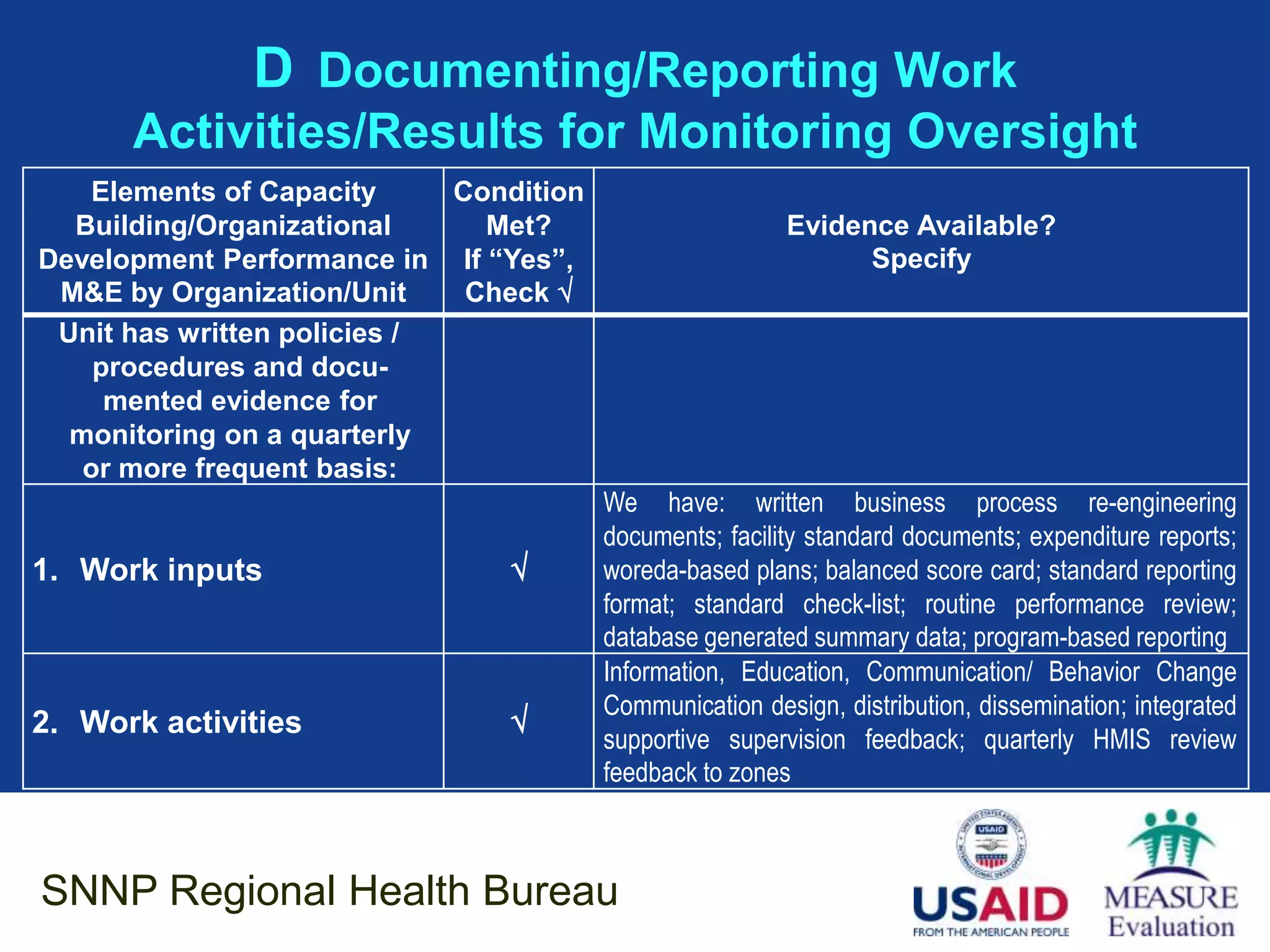

D Documenting/Reporting Work
      Activities/Results for Monitoring Oversight
    Elements of Capacity     Condition
  Building/Organizational      Met?                       Evidence Available?
Development Performance in If “Yes”,                            Specify
 M&E by Organization/Unit     Check 
 Unit has written policies /
    procedures and docu-
     mented evidence for
  monitoring on a quarterly
   or more frequent basis:
                                         We have: written business process re-engineering
                                         documents; facility standard documents; expenditure reports;
1. Work inputs                          woreda-based plans; balanced score card; standard reporting
                                         format; standard check-list; routine performance review;
                                         database generated summary data; program-based reporting
                                         Information, Education, Communication/ Behavior Change
                                         Communication design, distribution, dissemination; integrated
2. Work activities              
                                         supportive supervision feedback; quarterly HMIS review
                                         feedback to zones

SNNP Regional Health Bureau

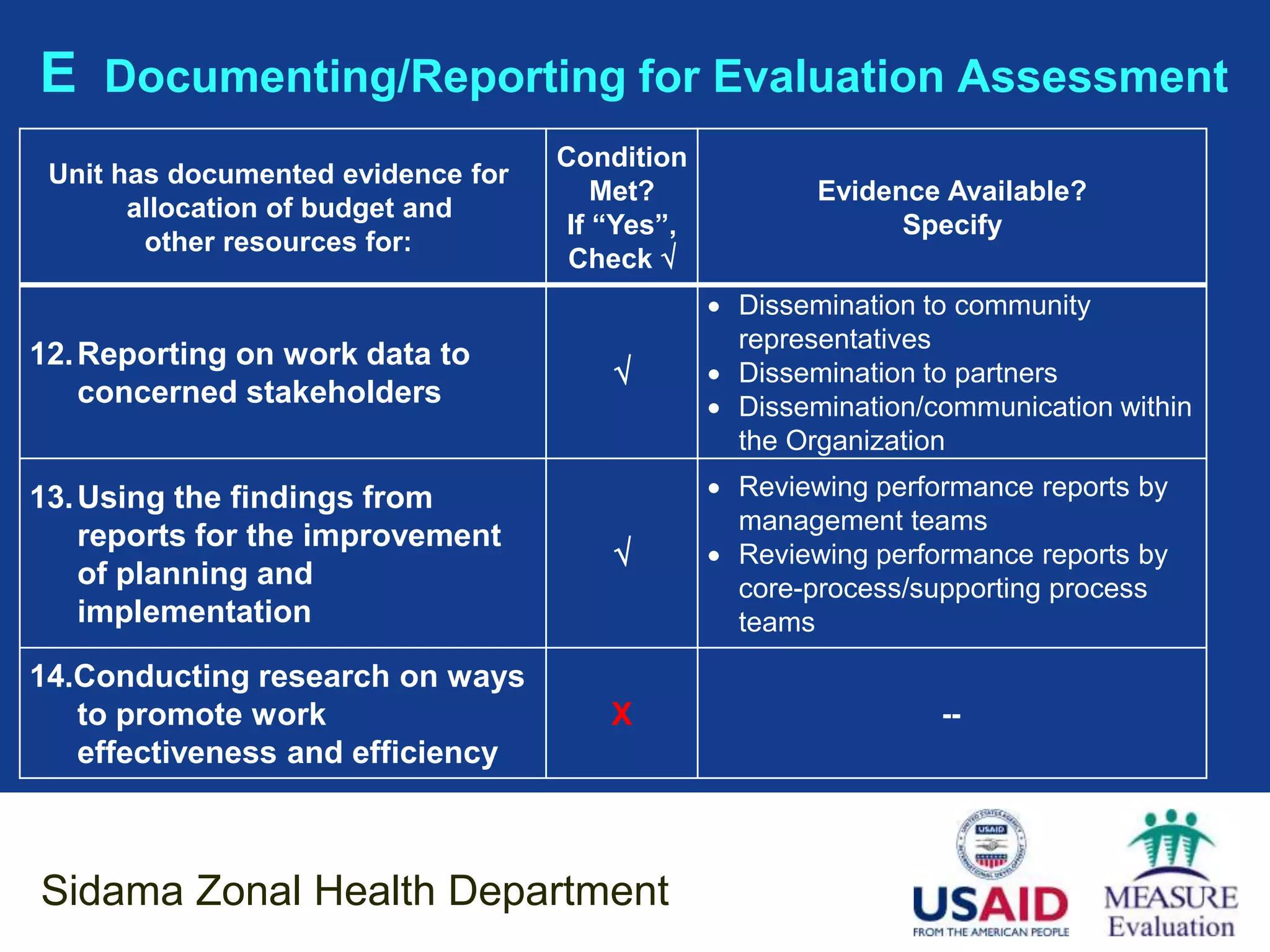

D Documenting/Reporting Work
      Activities/Results for Monitoring Oversight
   Elements of Capacity     Condition
  Building / Organizational   Met?                        Evidence Available?
Development Performance in If “Yes”,                            Specify
 M&E by Organization / Unit  Check 

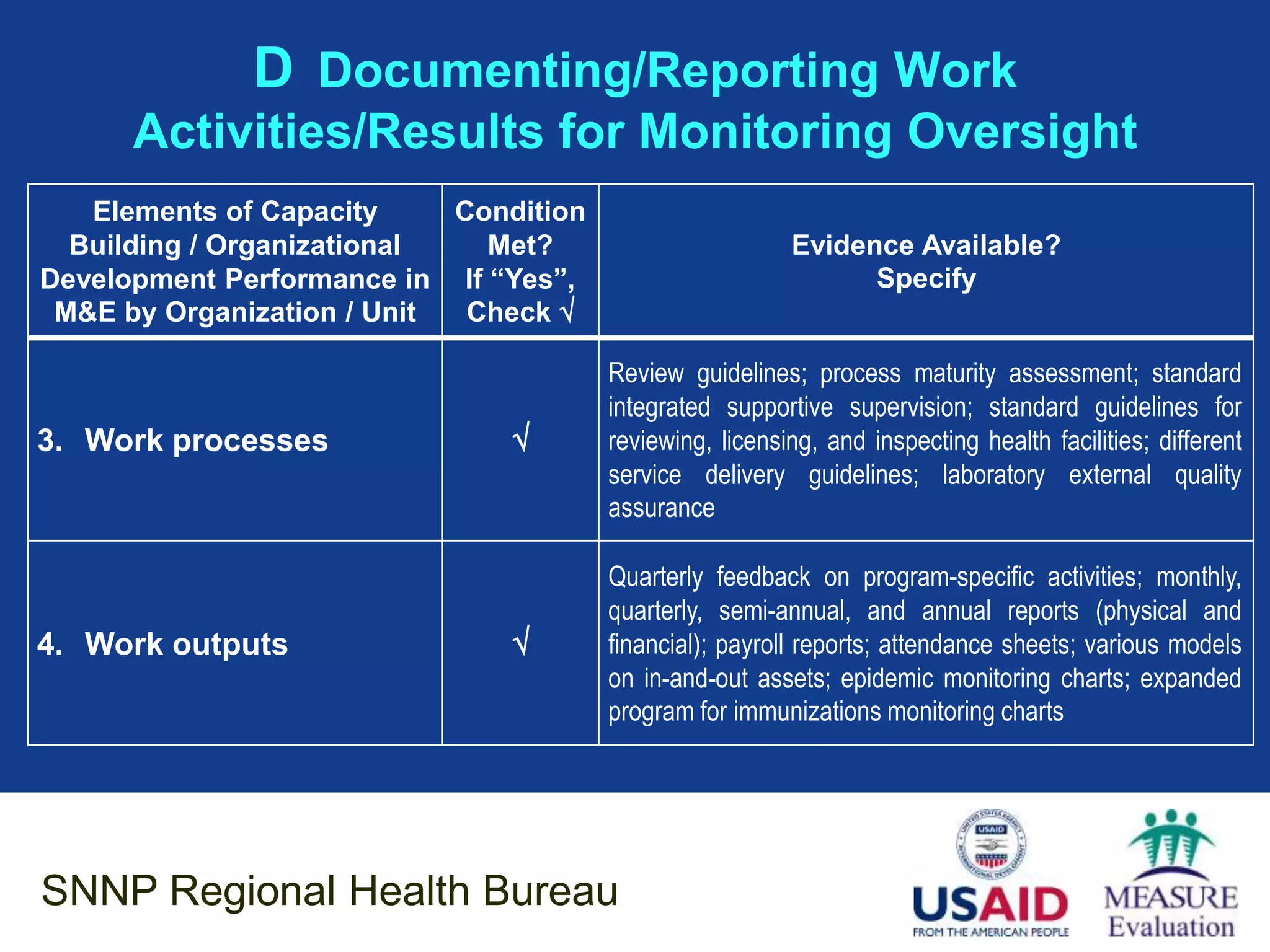

                                        Review guidelines; process maturity assessment; standard
                                        integrated supportive supervision; standard guidelines for
3. Work processes                      reviewing, licensing, and inspecting health facilities; different
                                        service delivery guidelines; laboratory external quality
                                        assurance

                                        Quarterly feedback on program-specific activities; monthly,
                                        quarterly, semi-annual, and annual reports (physical and
4. Work outputs                        financial); payroll reports; attendance sheets; various models
                                        on in-and-out assets; epidemic monitoring charts; expanded
                                        program for immunizations monitoring charts

SNNP Regional Health Bureau

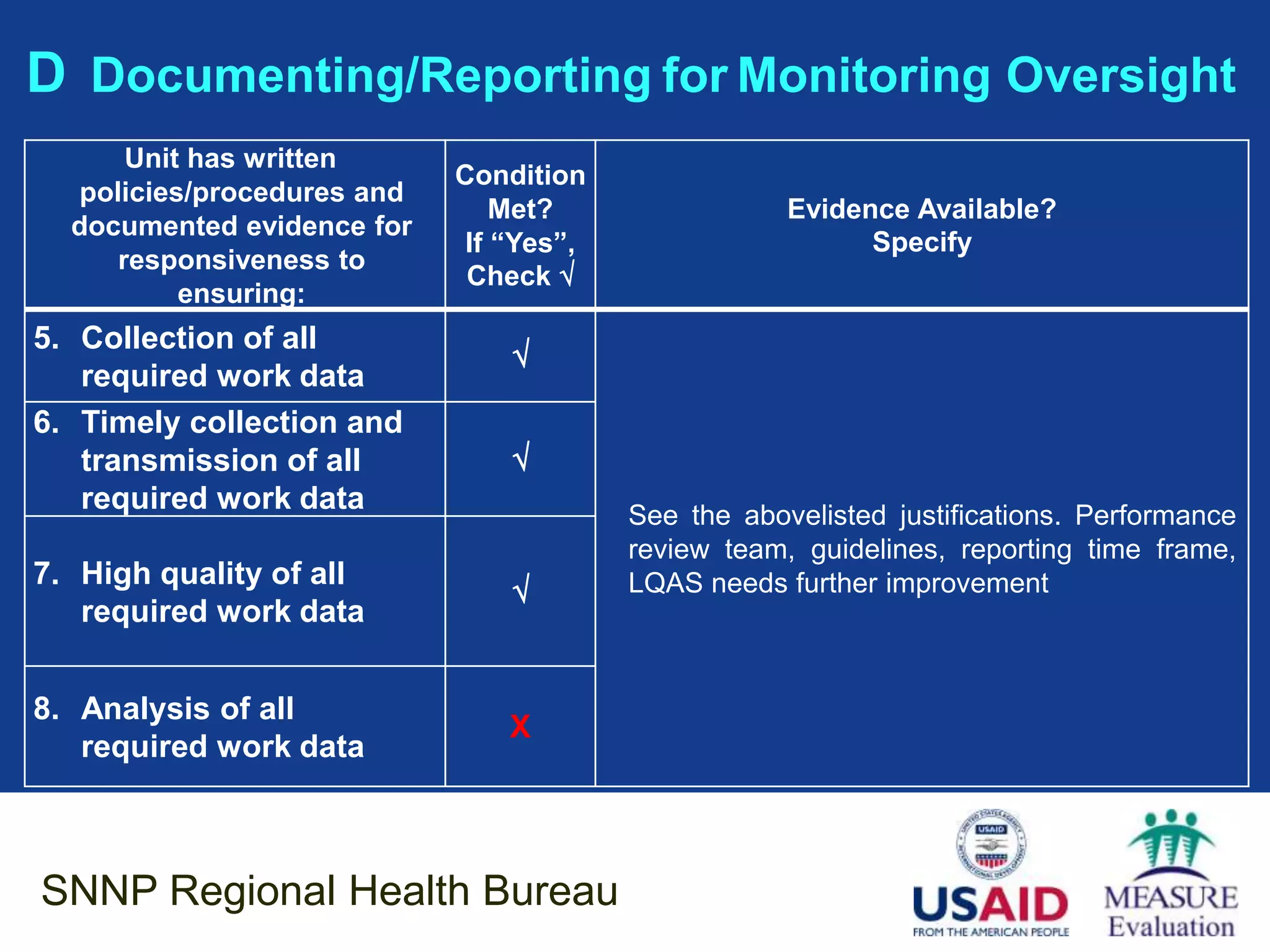

D Documenting/Reporting for Monitoring Oversight
      Unit has written
                            Condition
  policies/procedures and
                                Met?                 Evidence Available?
  documented evidence for
                             If “Yes”,                     Specify
     responsiveness to
                             Check 
          ensuring:
5. Collection of all
                                
   required work data
6. Timely collection and
   transmission of all          
   required work data
                                         See the abovelisted justifications. Performance
                                         review team, guidelines, reporting time frame,
7. High quality of all
                                        LQAS needs further improvement
   required work data

8. Analysis of all
                                X
   required work data

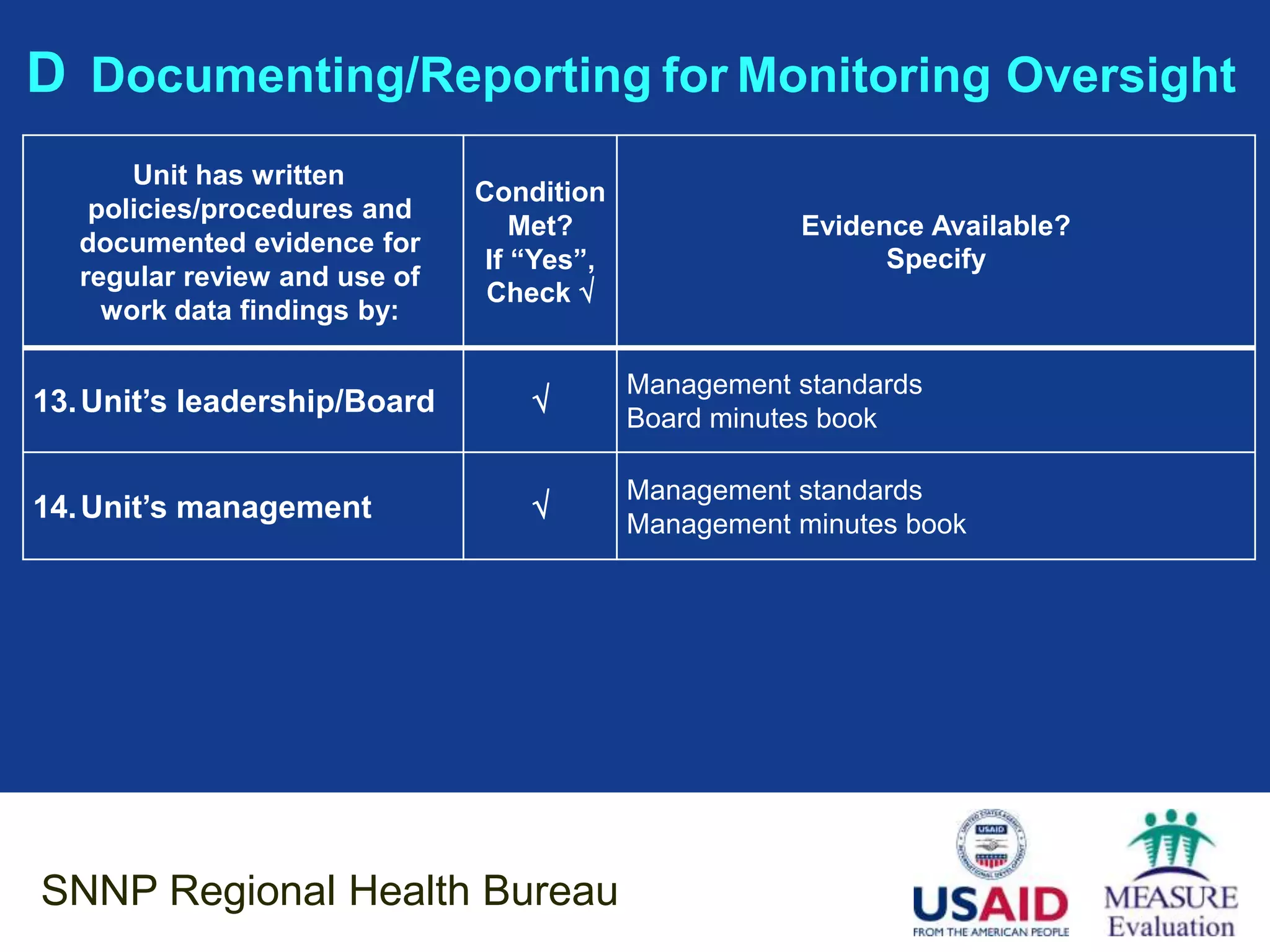

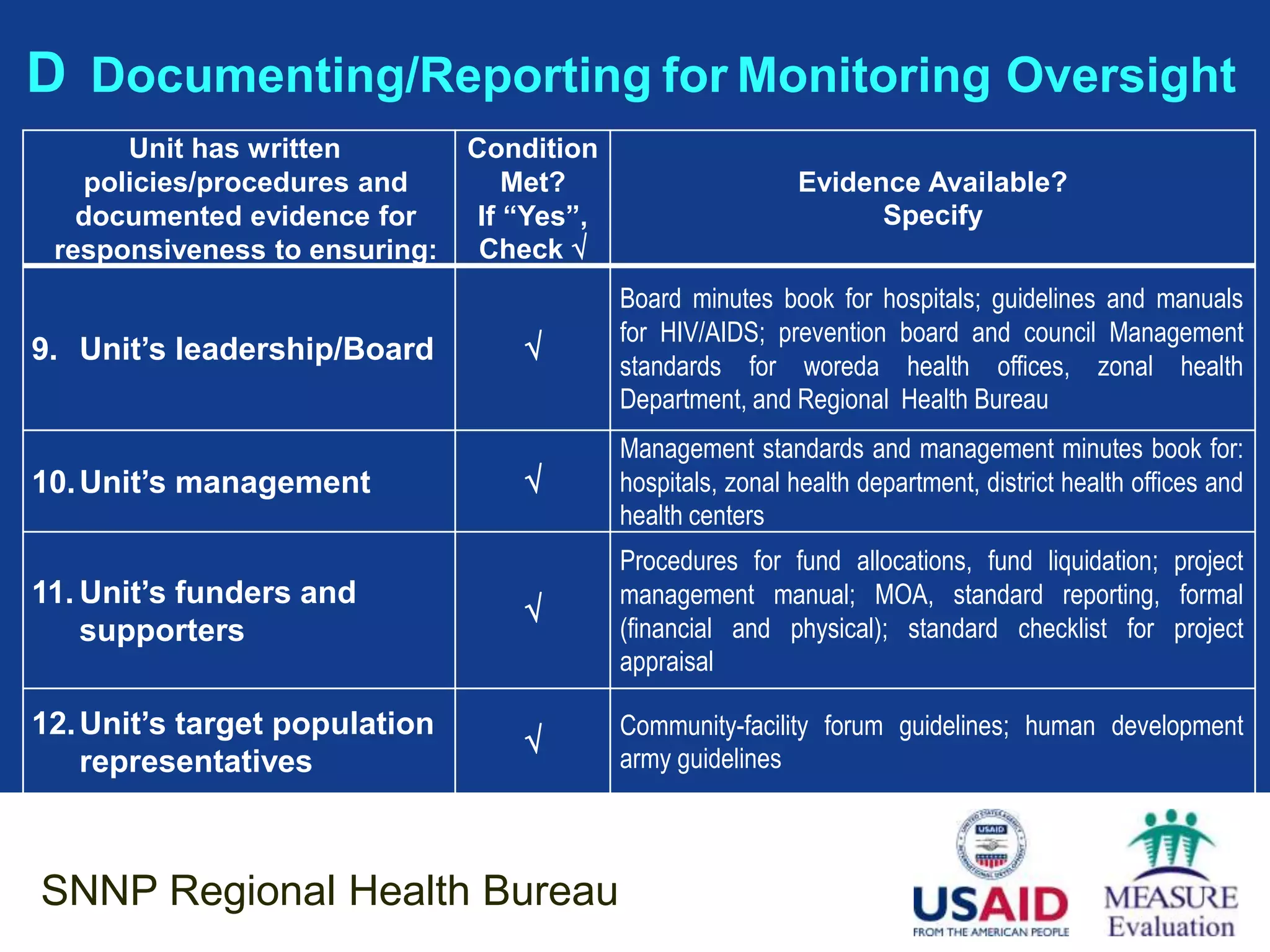

SNNP Regional Health Bureau
D Documenting/Reporting for Monitoring Oversight
      Unit has written         Condition
   policies/procedures and         Met?                      Evidence Available?
   documented evidence for      If “Yes”,                          Specify
 responsiveness to ensuring:    Check 
                                            Board minutes book for hospitals; guidelines and manuals
                                            for HIV/AIDS; prevention board and council Management
9. Unit’s leadership/Board         
                                            standards for woreda health offices, zonal health
                                            Department, and Regional Health Bureau
                                            Management standards and management minutes book for:
10. Unit’s management                      hospitals, zonal health department, district health offices and
                                            health centers
                                            Procedures for fund allocations, fund liquidation; project
11. Unit’s funders and                      management manual; MOA, standard reporting, formal
                                   
    supporters                              (financial and physical); standard checklist for project
                                            appraisal

12. Unit’s target population                Community-facility forum guidelines; human development
                                           army guidelines
    representatives

SNNP Regional Health Bureau
D Documenting/Reporting for Monitoring Oversight
       Unit has written
                               Condition
    policies/procedures and
                                   Met?                Evidence Available?
   documented evidence for
                                If “Yes”,                    Specify
   regular review and use of
                                Check 
     work data findings by:

                                            Management standards
13. Unit’s leadership/Board                Board minutes book

                                            Management standards
14. Unit’s management                      Management minutes book

SNNP Regional Health Bureau
D Documenting/Reporting for Monitoring Oversight

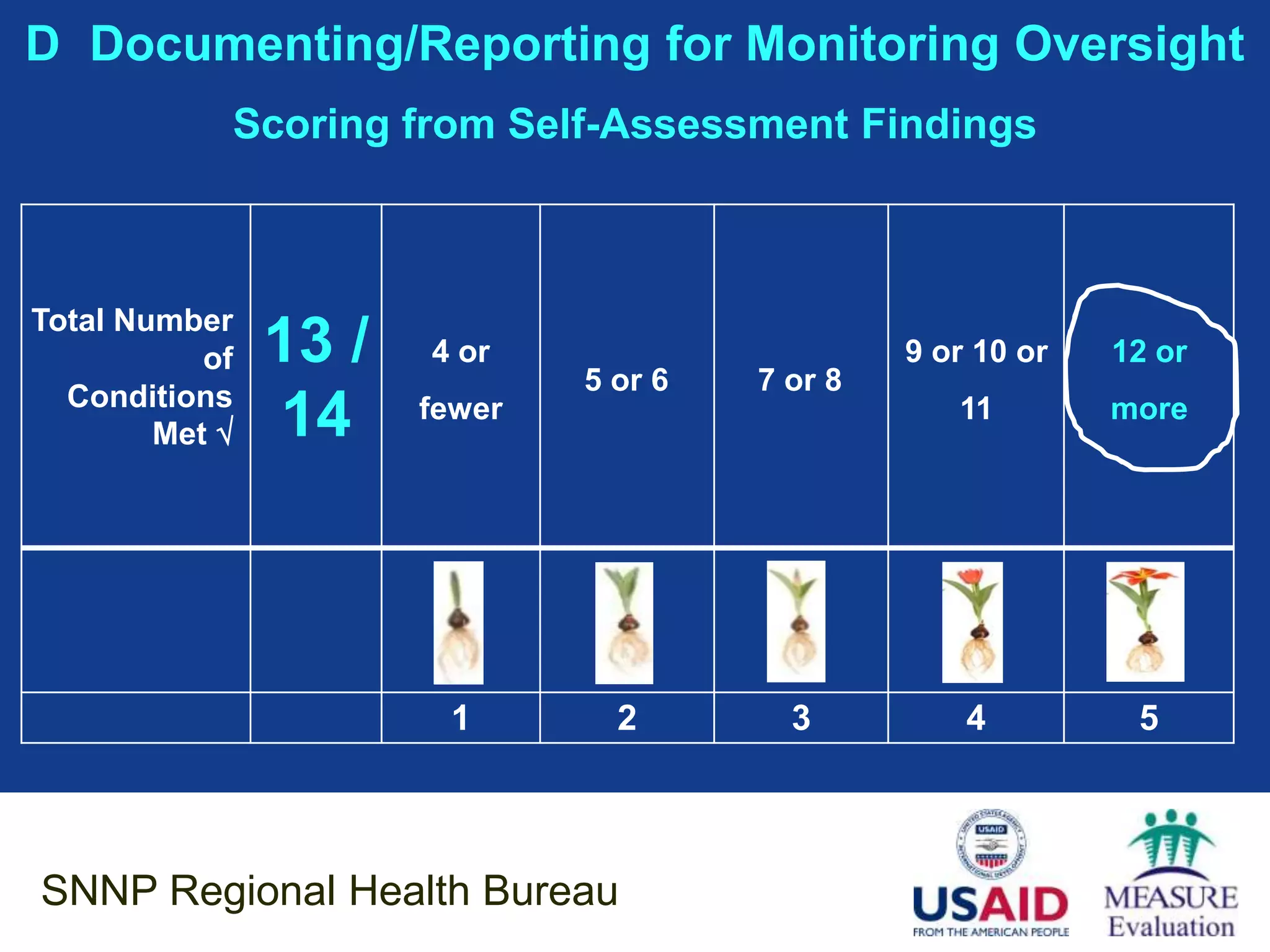

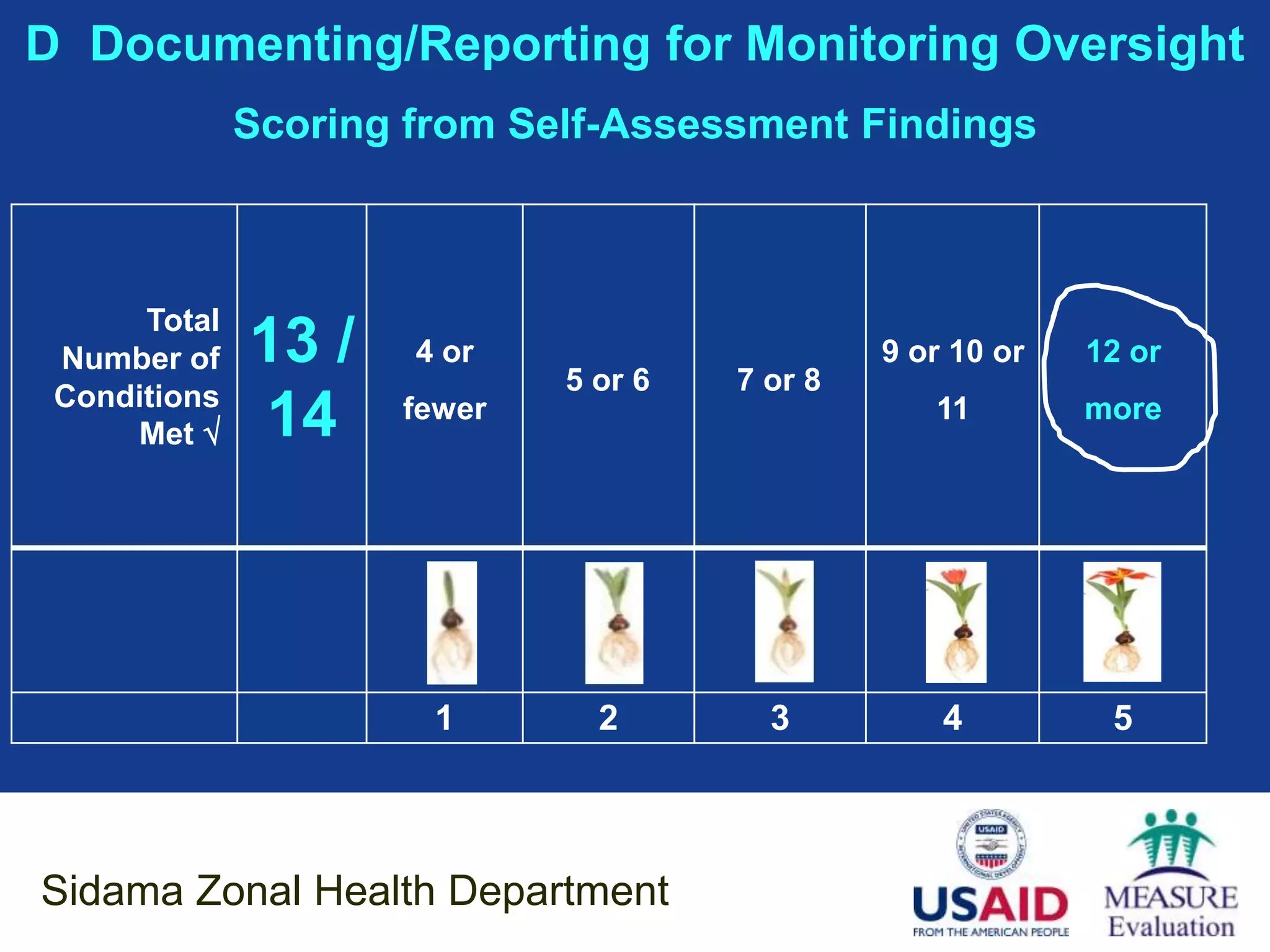

            Scoring from Self-Assessment Findings

Total Number
           of   13 /   4 or
                               5 or 6   7 or 8
                                                 9 or 10 or   12 or
  Conditions
        Met    14     fewer                        11        more

                        1        2        3          4         5

SNNP Regional Health Bureau
D Documenting/Reporting for Monitoring Oversight

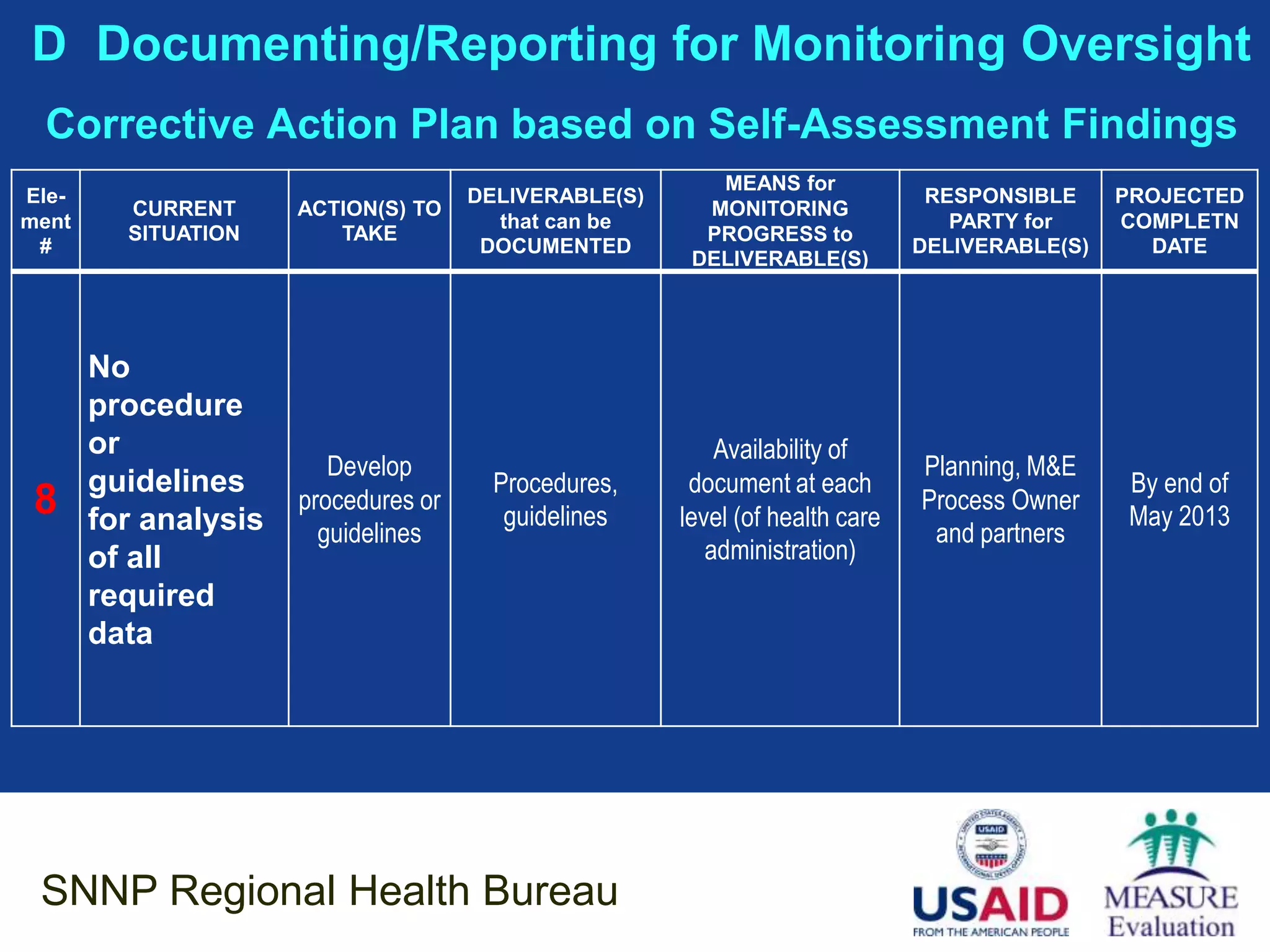

 Corrective Action Plan based on Self-Assessment Findings
                                                          MEANS for
Ele-                                  DELIVERABLE(S)                            RESPONSIBLE     PROJECTED
         CURRENT      ACTION(S) TO                       MONITORING
ment                                    that can be                               PARTY for     COMPLETN
         SITUATION       TAKE                            PROGRESS to
 #                                     DOCUMENTED                              DELIVERABLE(S)     DATE
                                                        DELIVERABLE(S)

       No
       procedure
       or                                                  Availability of
                         Develop                                               Planning, M&E
       guidelines                       Procedures,     document at each                        By end of
 8     for analysis
                      procedures or
                                         guidelines    level (of health care
                                                                               Process Owner
                                                                                                May 2013
                        guidelines                                              and partners
       of all                                             administration)
       required
       data

 SNNP Regional Health Bureau
E Documenting/Reporting Work
     Activities/Results for Evaluation Assessment
 Unit has written policies/procedures
 and documented evidence for having     Condition
 evaluated for work effectiveness and       Met?               Evidence Available?
  efficiency the projections that had    If “Yes”,                   Specify
   been set in Annual Budgets and        Check 
         Implementation Plans:

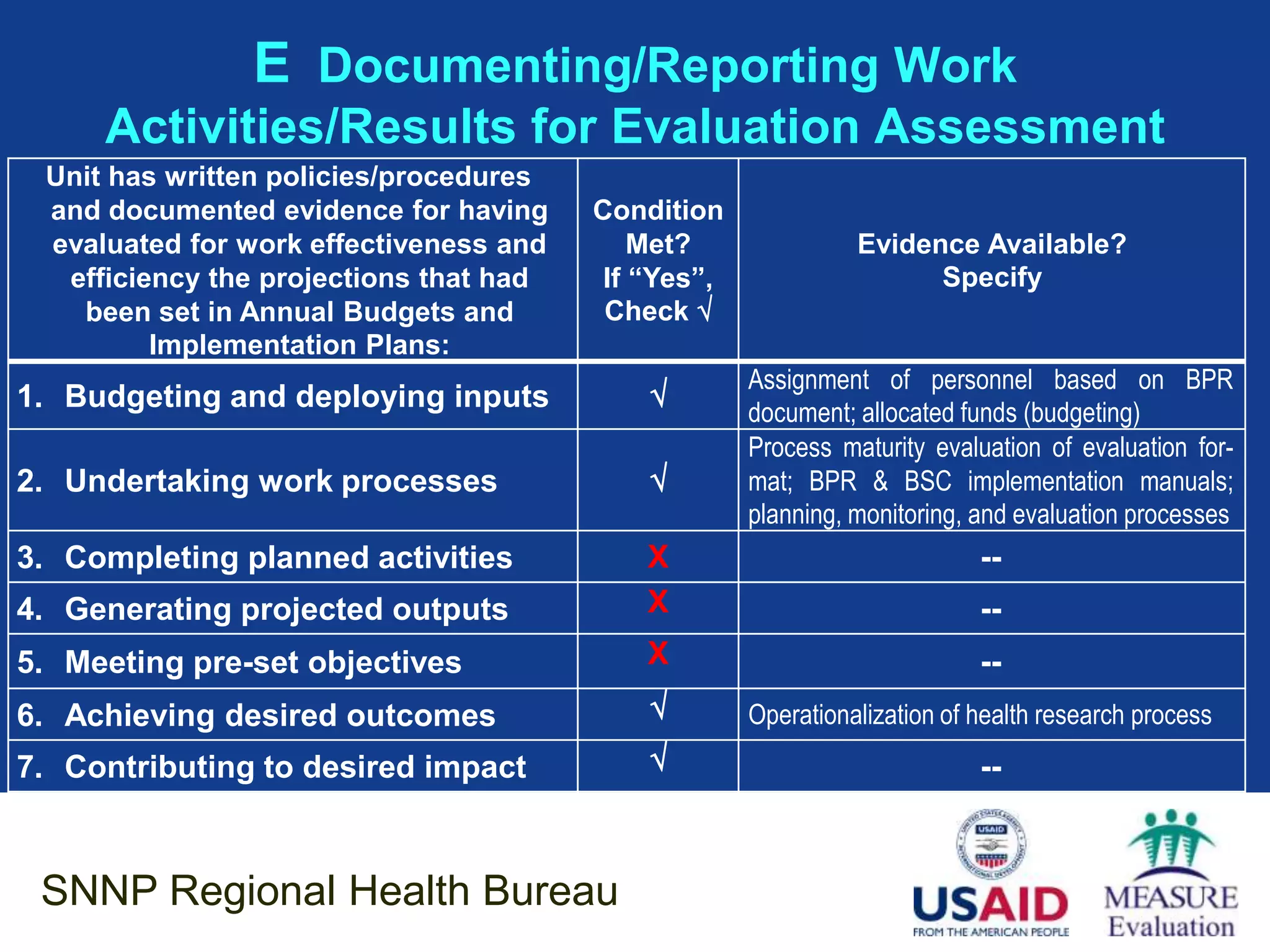

                                                     Assignment of personnel based on BPR
1. Budgeting and deploying inputs                   document; allocated funds (budgeting)
                                                     Process maturity evaluation of evaluation for-
2. Undertaking work processes                       mat; BPR & BSC implementation manuals;
                                                     planning, monitoring, and evaluation processes
3. Completing planned activities            X                              --
4. Generating projected outputs             X                              --
5. Meeting pre-set objectives               X                              --
6. Achieving desired outcomes                       Operationalization of health research process
7. Contributing to desired impact                                         --

 SNNP Regional Health Bureau

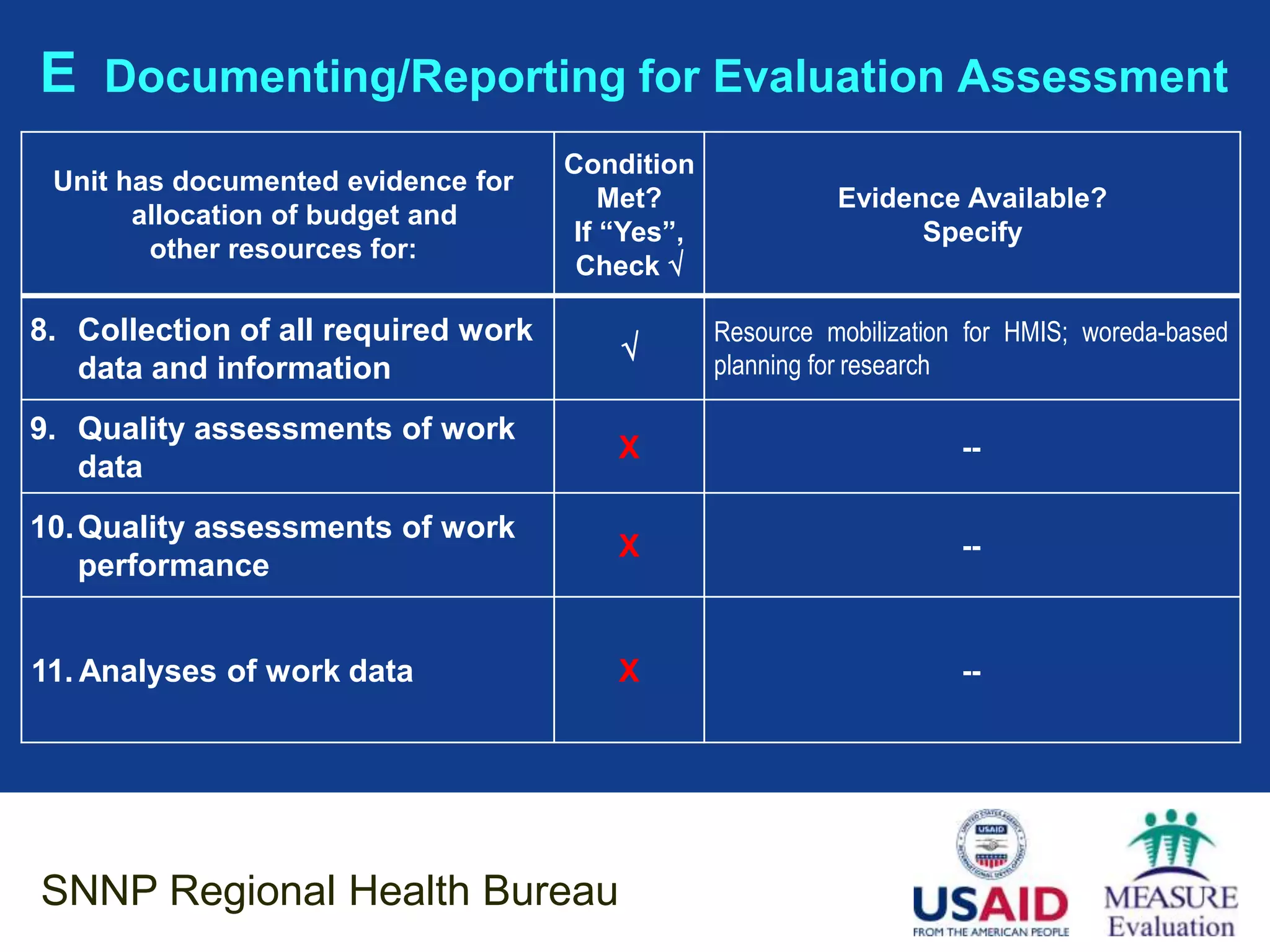

E Documenting/Reporting for Evaluation Assessment
                                     Condition
 Unit has documented evidence for
                                         Met?               Evidence Available?
       allocation of budget and
                                      If “Yes”,                   Specify
        other resources for:

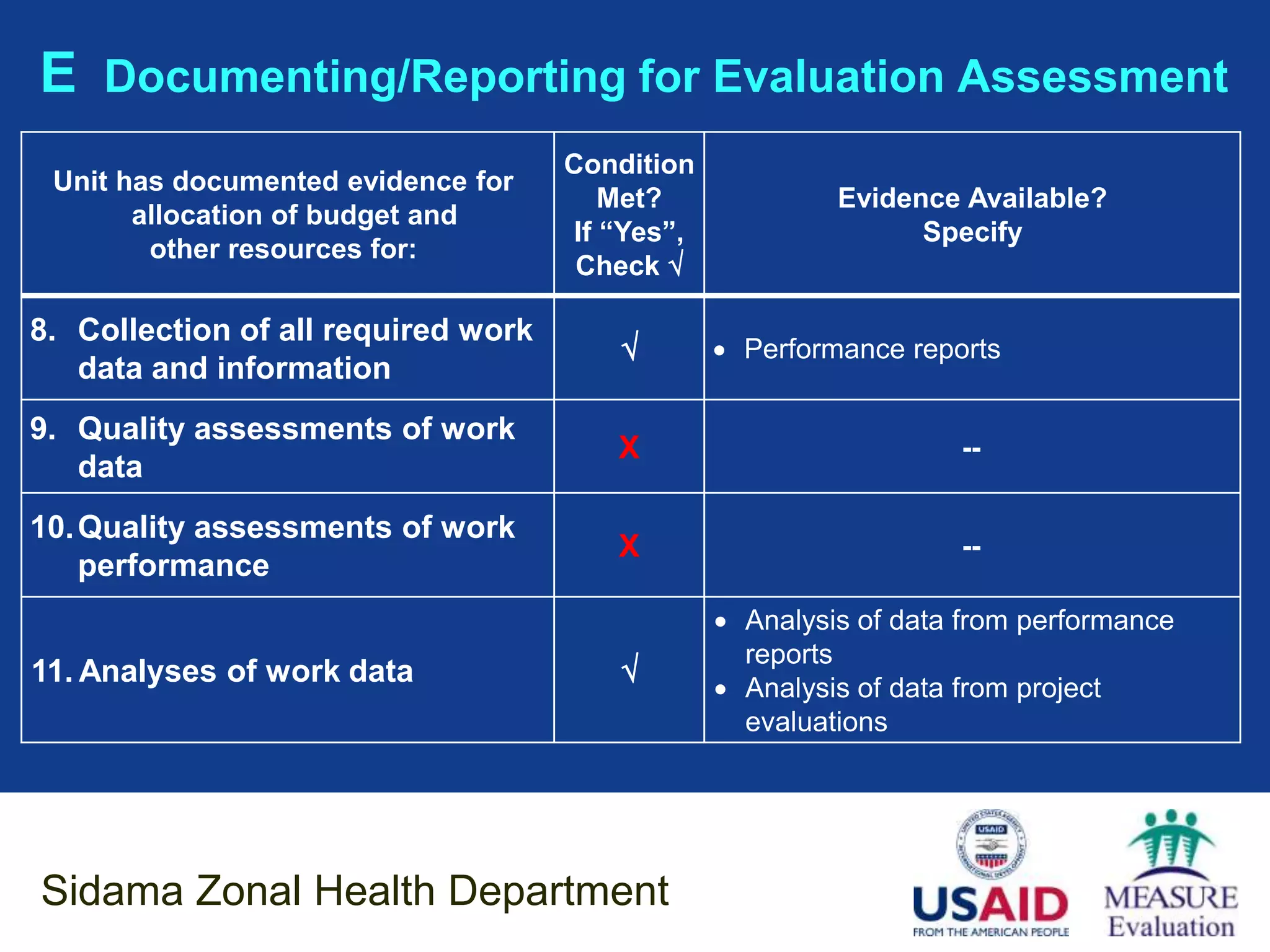

                                      Check 

8. Collection of all required work                Resource mobilization for HMIS; woreda-based
                                                 planning for research
   data and information
9. Quality assessments of work
                                         X                             --
   data
10. Quality assessments of work
                                         X                             --
    performance

11. Analyses of work data                X                             --

SNNP Regional Health Bureau
E Documenting/Reporting for Evaluation Assessment
                                    Condition
 Unit has documented evidence for
                                        Met?                Evidence Available?
       allocation of budget and
                                     If “Yes”,                    Specify
        other resources for:
                                     Check 

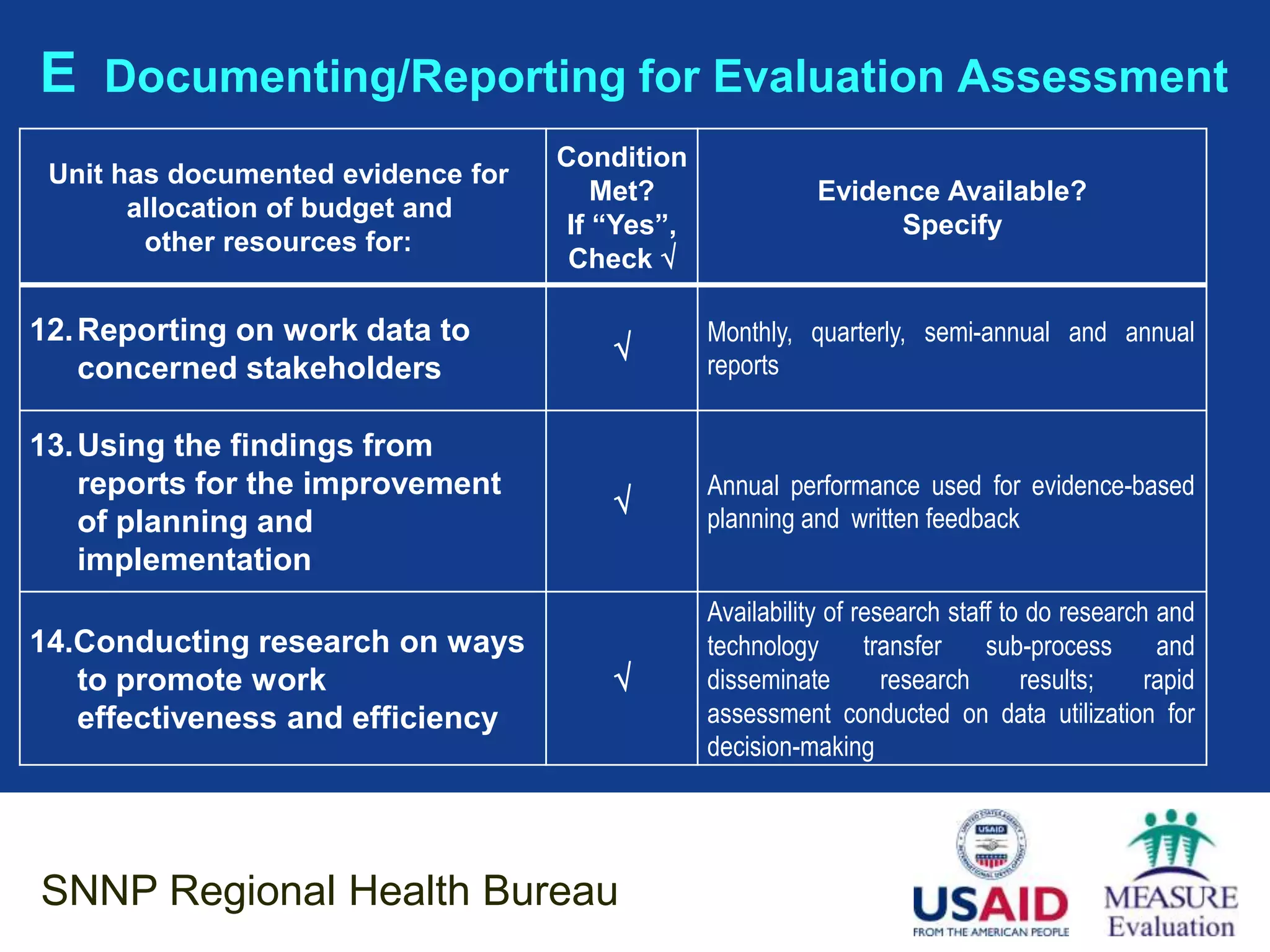

12. Reporting on work data to                    Monthly, quarterly, semi-annual and annual
                                                reports
    concerned stakeholders

13. Using the findings from
    reports for the improvement                  Annual performance used for evidence-based
                                                planning and written feedback
    of planning and
    implementation
                                                 Availability of research staff to do research and
14.Conducting research on ways                   technology       transfer    sub-process      and
   to promote work                              disseminate        research      results;    rapid
   effectiveness and efficiency                  assessment conducted on data utilization for
                                                 decision-making

SNNP Regional Health Bureau
E Documenting/Reporting for Evaluation Assessment

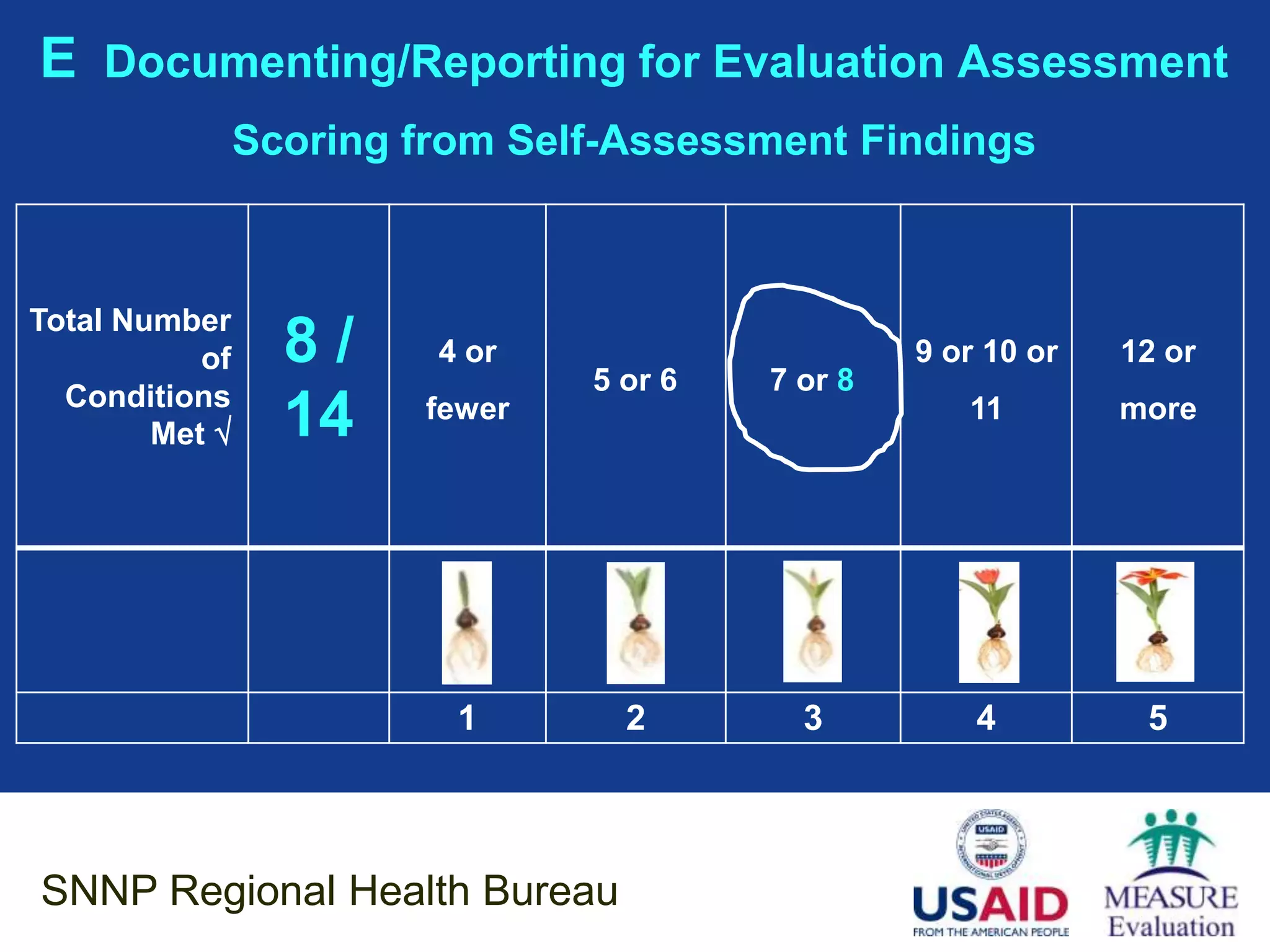

                Scoring from Self-Assessment Findings

Total Number
           of     8/     4 or
                                5 or 6   7 or 8
                                                  9 or 10 or   12 or
  Conditions
        Met      14    fewer                        11        more

                          1       2        3          4         5

SNNP Regional Health Bureau
E Documenting/Reporting for Evaluation Assessment

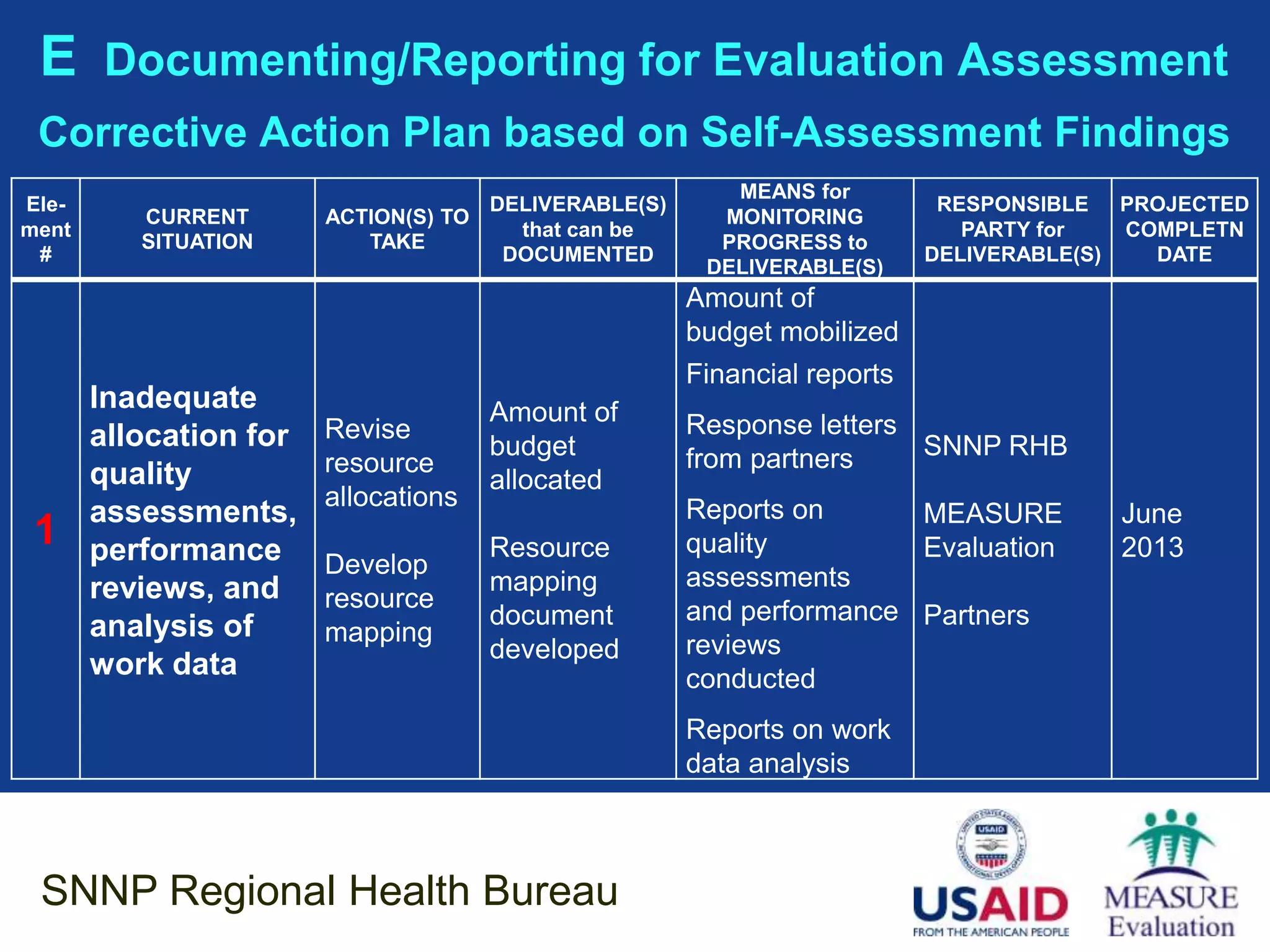

 Corrective Action Plan based on Self-Assessment Findings
                                                           MEANS for
Ele-                                   DELIVERABLE(S)                        RESPONSIBLE PROJECTED
          CURRENT       ACTION(S) TO                      MONITORING
ment                                     that can be                           PARTY for   COMPLETN
          SITUATION        TAKE                           PROGRESS to
 #                                      DOCUMENTED                          DELIVERABLE(S)   DATE
                                                         DELIVERABLE(S)
                                                        Amount of
                                                        budget mobilized
                                                        Financial reports
       Inadequate                      Amount of
       allocation for   Revise                          Response letters
                                       budget           from partners    SNNP RHB
       quality          resource
                                       allocated
                        allocations                     Reports on
       assessments,                                                     MEASURE          June
 1     performance                     Resource         quality         Evaluation       2013
                        Develop                         assessments
       reviews, and                    mapping
                        resource                        and performance Partners
       analysis of                     document
                        mapping                         reviews
                                       developed
       work data                                        conducted
                                                        Reports on work
                                                        data analysis

 SNNP Regional Health Bureau
E Documenting/Reporting for Evaluation Assessment
 Corrective Action Plan based on Self-Assessment Findings
                                                                    MEANS for
Ele-                                          DELIVERABLE(S)                           RESPONSIBLE     PROJECTED
          CURRENT          ACTION(S) TO                            MONITORING
ment                                            that can be                              PARTY for     COMPLETN
          SITUATION           TAKE                                 PROGRESS to
 #                                             DOCUMENTED                             DELIVERABLE(S)     DATE
                                                                  DELIVERABLE(S)

                                                                 Terms of reference

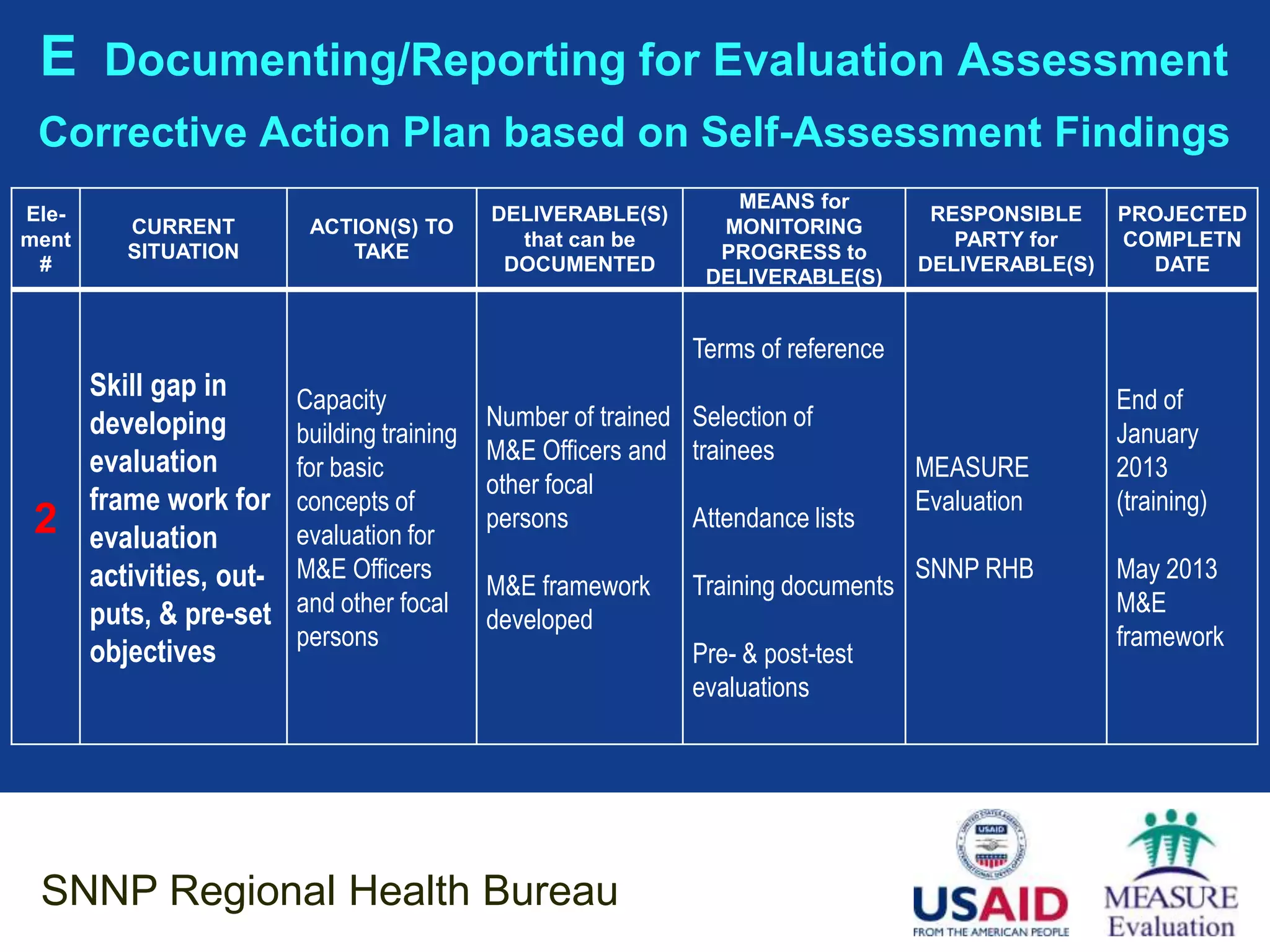

       Skill gap in       Capacity                                                                     End of
       developing                             Number of trained Selection of
                          building training                                                            January
       evaluation                             M&E Officers and trainees
                          for basic                                                   MEASURE          2013
                                              other focal
       frame work for     concepts of                                                 Evaluation       (training)
 2                                            persons           Attendance lists
       evaluation         evaluation for
       activities, out-   M&E Officers                                                SNNP RHB         May 2013
                                              M&E framework      Training documents
       puts, & pre-set    and other focal                                                              M&E
                                              developed
                          persons                                                                      framework
       objectives                                                Pre- & post-test
                                                                 evaluations

 SNNP Regional Health Bureau
NEXT PRESENTATION
SCORE ME Self-Assessment of M&E Capacity
    Sidama Zonal Health Department
            01 December 2012
Organization’s Functional Capacities
       for Self-Assessment in M&E Performance
A Strategic Planning
B Budgeting and Managing Finances
C Implementation Planning
D Documenting/Reporting Work Activities/Results for Monitoring Oversight
E Documenting/Reporting Work Activities/Results for Evaluation Assessment
F   Managing Facilities and Physical Assets
G Managing and Developing Staff
H Promoting Continuous Quality Improvement

Sidama Zonal Health Department
D Documenting/Reporting Work
       Activities/Results for Monitoring Oversight
                                           Condition
    Elements of Capacity Building /
                                               Met?            Evidence Available?
Organizational Development Performance
                                            If “Yes”,                Specify
     in M&E by Organization / Unit
                                            Check 
Unit has written policies/procedures and
  documented evidence for monitoring
 on a quarterly or more frequent basis:

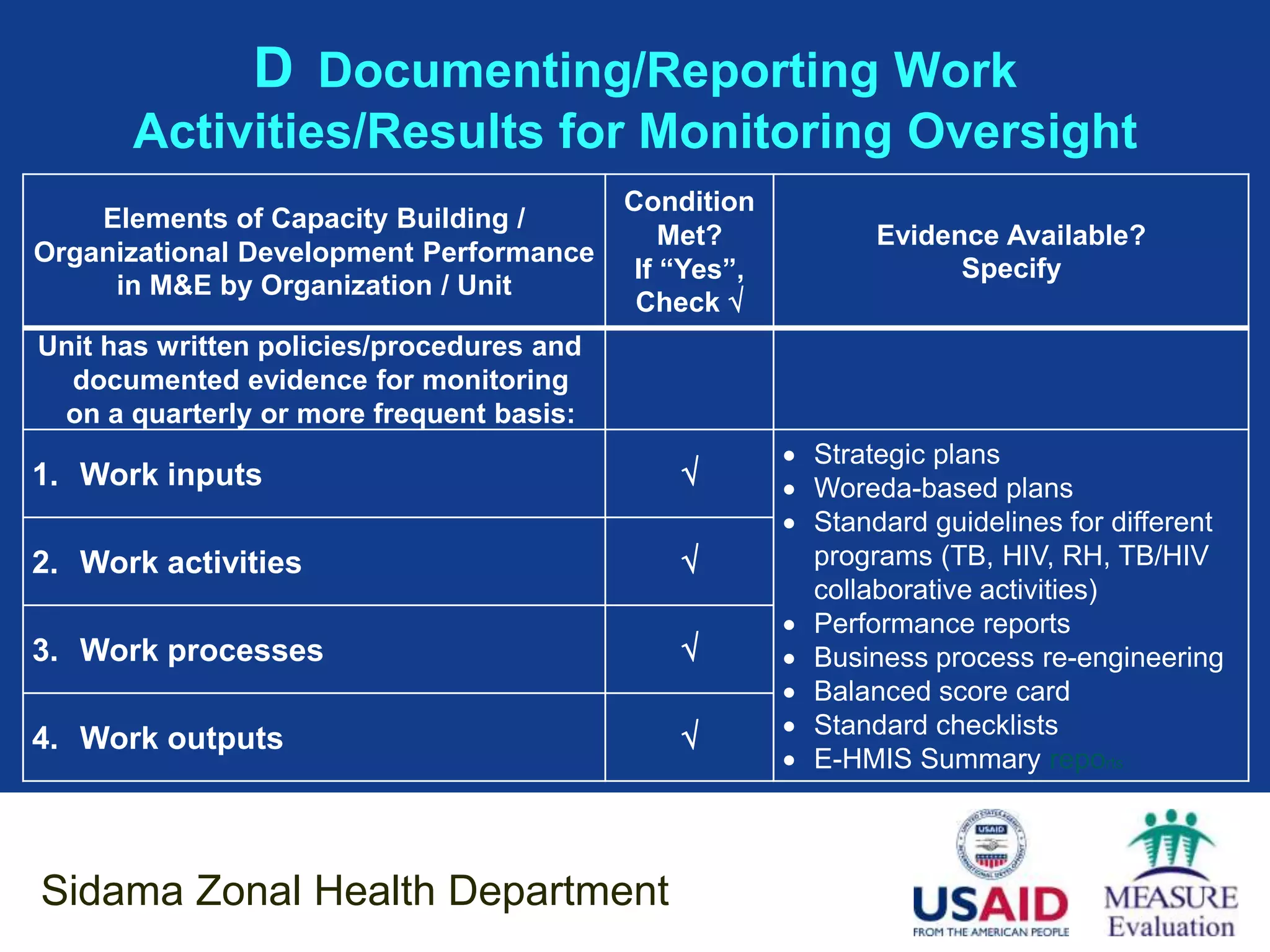

                                                         Strategic plans
1. Work inputs                                          Woreda-based plans
                                                         Standard guidelines for different
2. Work activities                                       programs (TB, HIV, RH, TB/HIV
                                                          collaborative activities)
                                                         Performance reports
3. Work processes                                       Business process re-engineering
                                                         Balanced score card
                                                        Standard checklists
4. Work outputs
                                                         E-HMIS Summary reports

Sidama Zonal Health Department
D Documenting/Reporting for Monitoring Oversight
                                           Condition
Unit has written policies/procedures and
                                               Met?            Evidence Available?
         documented evidence for
                                            If “Yes”,                Specify
       responsiveness to ensuring:
                                            Check 

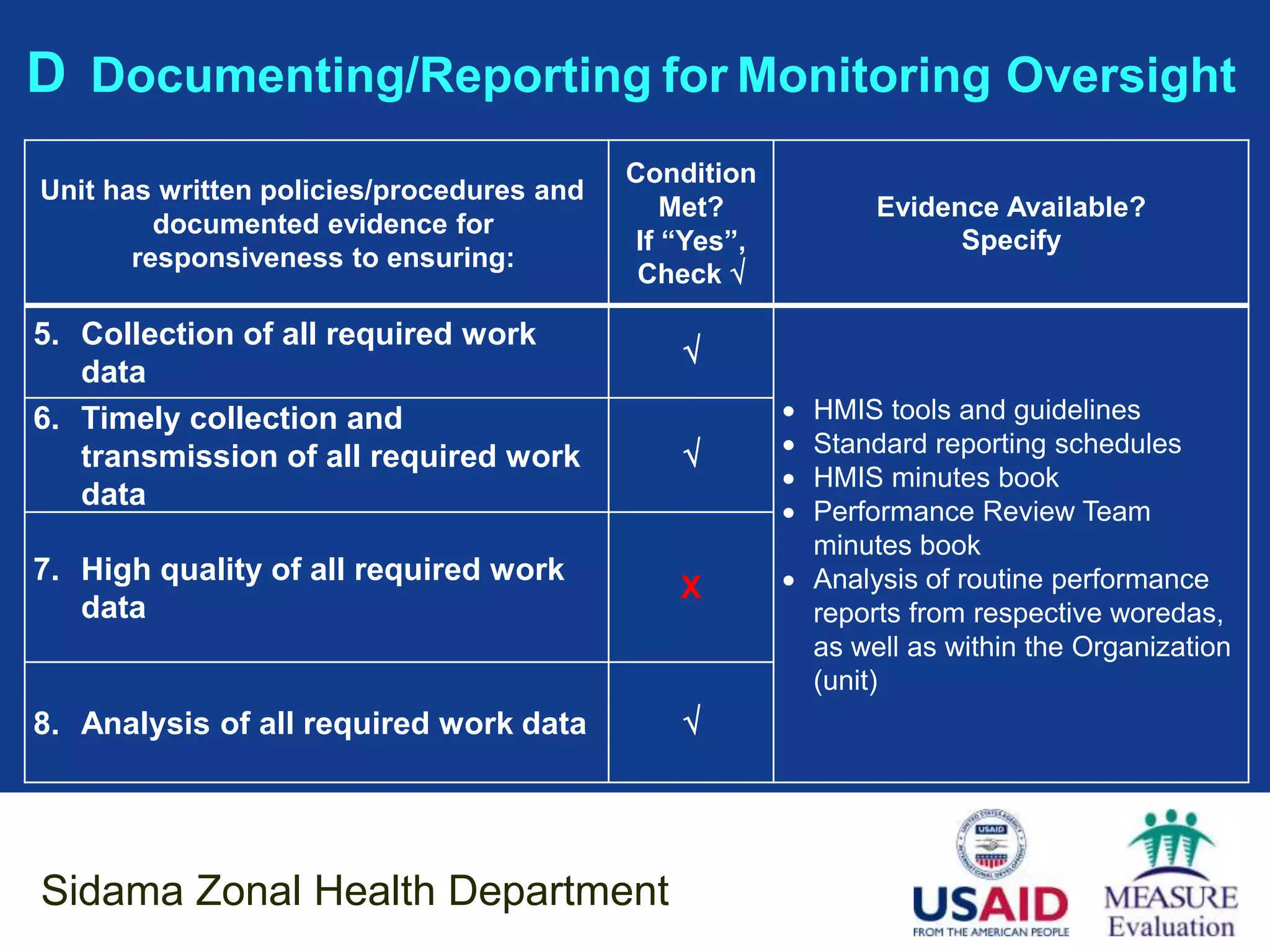

5. Collection of all required work
                                               
   data
6. Timely collection and                                 HMIS tools and guidelines
   transmission of all required work                    Standard reporting schedules
                                                         HMIS minutes book
   data
                                                         Performance Review Team
                                                          minutes book
7. High quality of all required work                     Analysis of routine performance
                                               X
   data                                                   reports from respective woredas,
                                                          as well as within the Organization
                                                          (unit)
8. Analysis of all required work data          

Sidama Zonal Health Department
D Documenting/Reporting for Monitoring Oversight
                                           Condition
Unit has written policies/procedures and
                                               Met?            Evidence Available?
         documented evidence for
                                            If “Yes”,                Specify
       responsiveness to ensuring:
                                            Check 
9. Unit’s leadership/Board                     
                                                         Management minutes book
                                                         Management standards
10. Unit’s management                          
                                                         Regular monthly/quarterly
11. Unit’s funders and supporters                        reporting, including review
                                                          meetings with concerned bodies
12. Unit’s target population                             Contractual agreements with
                                                         partners
    representatives
                                                         Standard checklists

13. Unit’s leadership/Board                    
                                                         Management minutes book
                                                         Management standards
14. Unit’s management                          

Sidama Zonal Health Department
D Documenting/Reporting for Monitoring Oversight
              Scoring from Self-Assessment Findings

      Total
 Number of    13 /    4 or
                             5 or 6   7 or 8
                                               9 or 10 or   12 or
 Conditions
     Met     14     fewer                        11        more

                       1       2        3          4         5

Sidama Zonal Health Department
D Documenting/Reporting for Monitoring Oversight

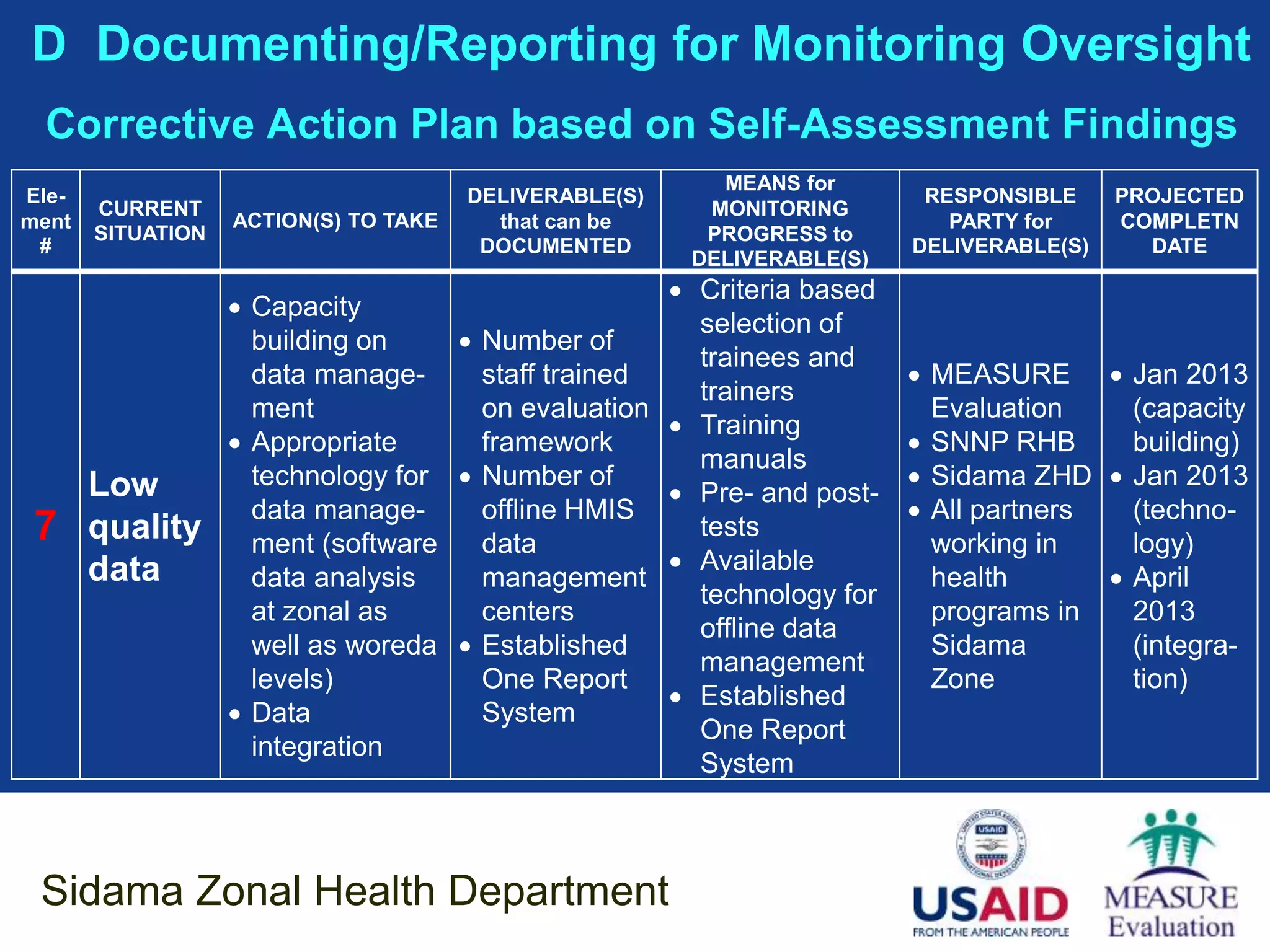

 Corrective Action Plan based on Self-Assessment Findings
                                                           MEANS for
Ele-                                   DELIVERABLE(S)                       RESPONSIBLE     PROJECTED
       CURRENT                                            MONITORING
ment               ACTION(S) TO TAKE     that can be                          PARTY for     COMPLETN
       SITUATION                                          PROGRESS to
 #                                      DOCUMENTED                         DELIVERABLE(S)     DATE
                                                         DELIVERABLE(S)
                                                         Criteria based
                    Capacity
                                                          selection of
                     building on     Number of
                                                          trainees and
                     data manage-     staff trained                         MEASURE  Jan 2013
                                                          trainers
                     ment             on evaluation                          Evaluation     (capacity
                                                         Training
                    Appropriate      framework                             SNNP RHB       building)
                                                          manuals
   Low               technology for  Number of                             Sidama ZHD  Jan 2013
                                                         Pre- and post-
                     data manage-     offline HMIS                          All partners   (techno-
 7 quality           ment (software   data
                                                          tests
                                                                             working in     logy)
   data                                                  Available
                     data analysis    management                             health        April
                                                          technology for
                     at zonal as      centers                                programs in    2013
                                                          offline data
                     well as woreda  Established                            Sidama         (integra-
                                                          management
                     levels)          One Report                             Zone           tion)
                                                         Established
                    Data             System
                                                          One Report
                     integration
                                                          System

 Sidama Zonal Health Department
E Documenting/Reporting Work
     Activities/Results for Evaluation Assessment
   Unit has written policies/procedures and
                                                Condition
   documented evidence for having evaluated
                                                    Met?      Evidence Available?
     for work effectiveness and efficiency
                                                 If “Yes”,          Specify
  the projections that had been set in Annual
                                                 Check 
       Budgets and Implementation Plans:
1. Budgeting and deploying inputs                   X                 --
2. Undertaking work processes                               Performance Report
3. Completing planned activities                    X                 --
4. Generating projected outputs                     X                 --
5. Meeting pre-set objectives                       X                 --
6. Achieving desired outcomes                       X                 --
7. Contributing to desired impact                   X                 --

 Sidama Zonal Health Department
E Documenting/Reporting for Evaluation Assessment
                                     Condition
 Unit has documented evidence for
                                         Met?              Evidence Available?
       allocation of budget and
                                      If “Yes”,                  Specify
        other resources for:
                                      Check 

8. Collection of all required work
                                                  Performance reports
   data and information
9. Quality assessments of work
                                         X                          --
   data
10. Quality assessments of work
                                         X                          --
    performance
                                                   Analysis of data from performance
                                                    reports
11. Analyses of work data                         Analysis of data from project
                                                    evaluations

Sidama Zonal Health Department
E Documenting/Reporting for Evaluation Assessment
                                    Condition
 Unit has documented evidence for
                                        Met?             Evidence Available?
       allocation of budget and
                                     If “Yes”,                 Specify
        other resources for:
                                     Check 
                                                  Dissemination to community
                                                   representatives
12. Reporting on work data to
                                                 Dissemination to partners
    concerned stakeholders                        Dissemination/communication within
                                                   the Organization

13. Using the findings from                       Reviewing performance reports by
                                                   management teams
    reports for the improvement
                                                 Reviewing performance reports by
    of planning and                                core-process/supporting process
    implementation                                 teams
14.Conducting research on ways
   to promote work                      X                         --
   effectiveness and efficiency

Sidama Zonal Health Department
E Documenting/Reporting for Evaluation Assessment

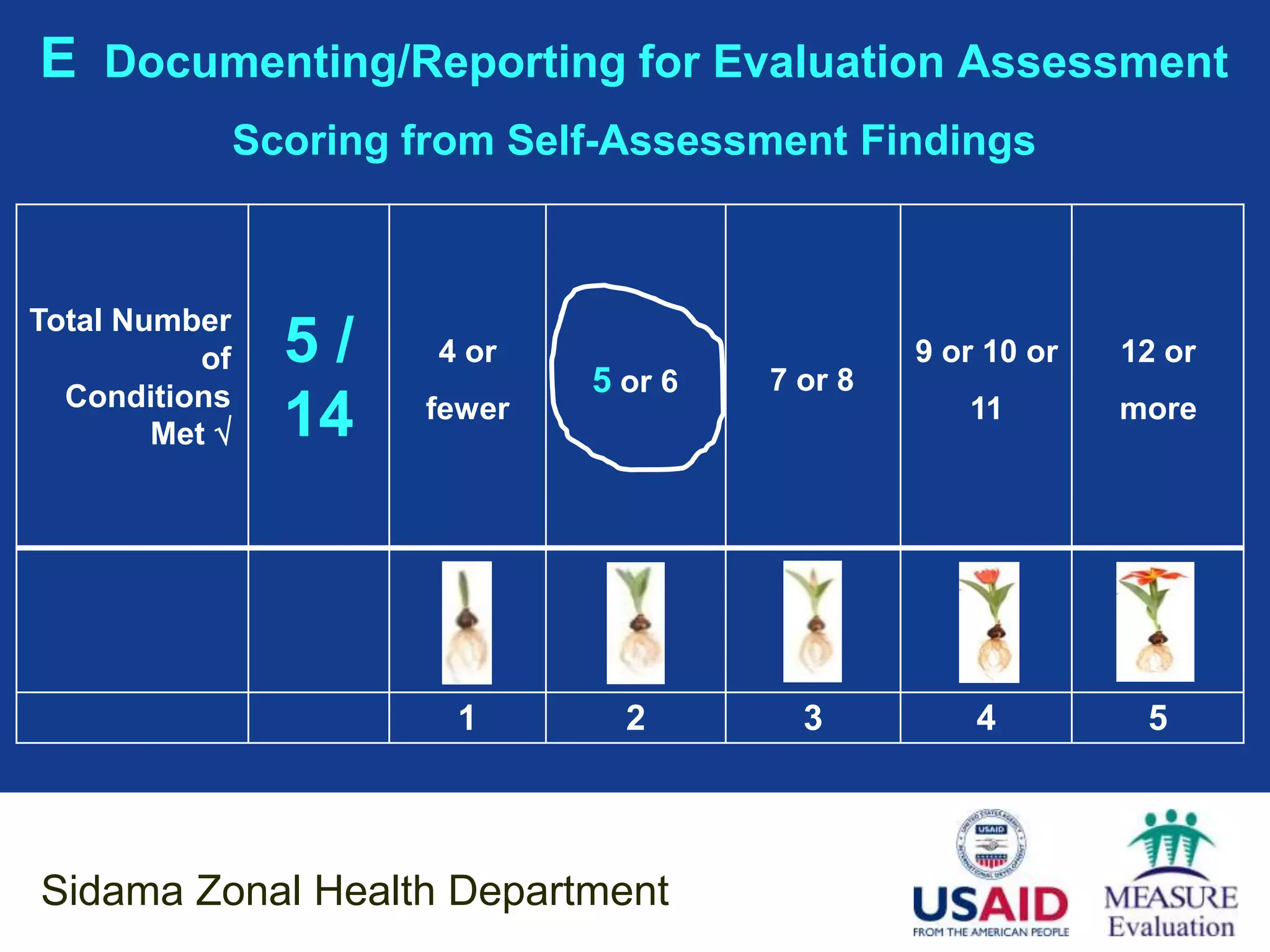

                Scoring from Self-Assessment Findings

Total Number
           of     5/     4 or
                                5 or 6   7 or 8
                                                  9 or 10 or   12 or
  Conditions
        Met      14    fewer                        11        more

                          1       2        3          4         5

Sidama Zonal Health Department
E Documenting/Reporting for Evaluation Assessment

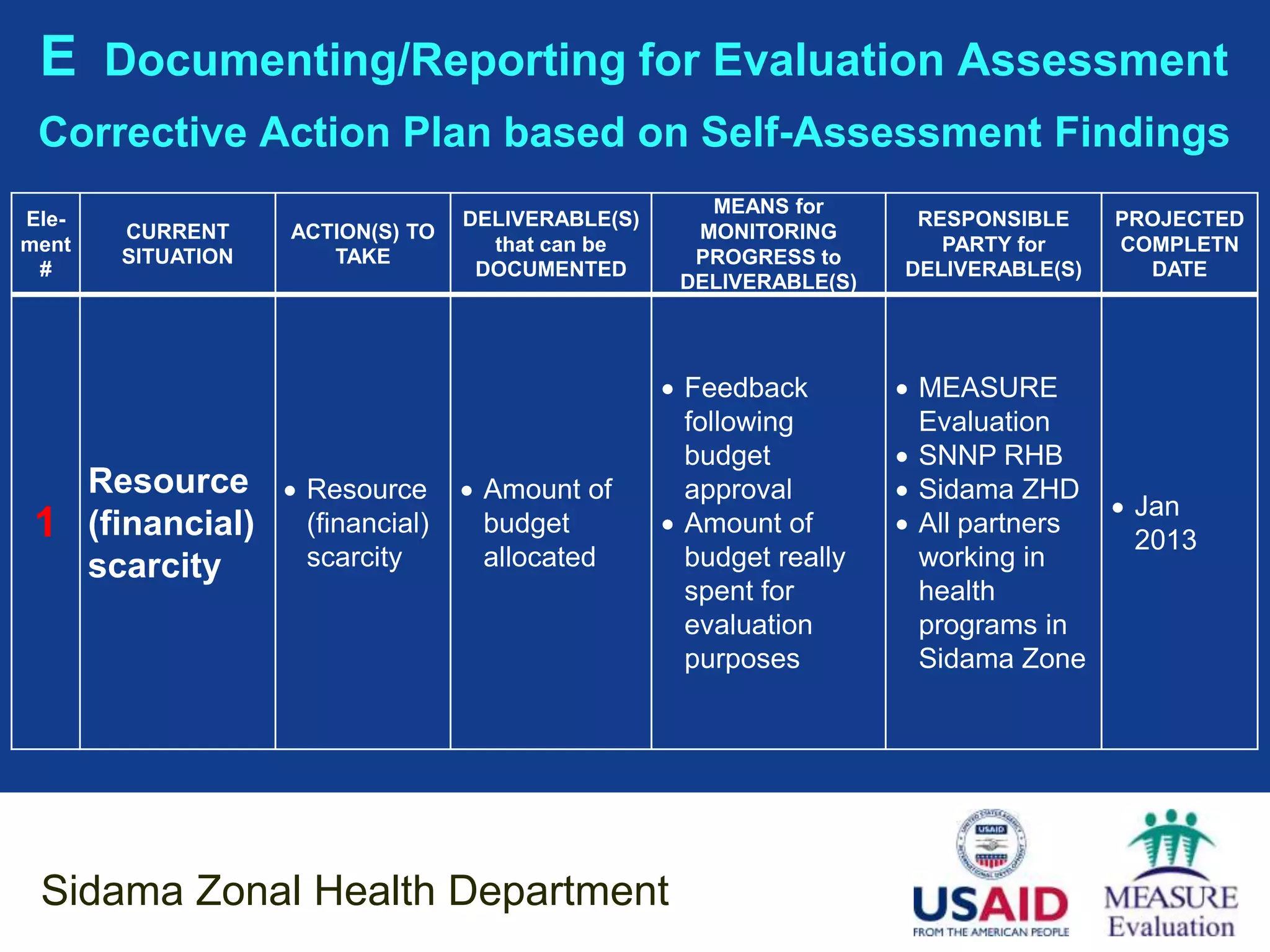

 Corrective Action Plan based on Self-Assessment Findings
                                                       MEANS for
Ele-                               DELIVERABLE(S)                      RESPONSIBLE     PROJECTED
       CURRENT     ACTION(S) TO                       MONITORING
ment                                 that can be                         PARTY for     COMPLETN
       SITUATION      TAKE                            PROGRESS to
 #                                  DOCUMENTED                        DELIVERABLE(S)     DATE
                                                     DELIVERABLE(S)

                                                     Feedback         MEASURE
                                                      following         Evaluation
                                                      budget           SNNP RHB
   Resource         Resource       Amount of        approval         Sidama ZHD
                                                                                      Jan
 1 (financial)       (financial)     budget          Amount of        All partners
                                                                                       2013
   scarcity          scarcity        allocated        budget really     working in
                                                      spent for         health
                                                      evaluation        programs in
                                                      purposes          Sidama Zone

 Sidama Zonal Health Department
E Documenting/Reporting for Evaluation Assessment
 Corrective Action Plan based on Self-Assessment Findings
                                                           MEANS for
Ele-                                    DELIVERABLE(S)                      RESPONSIBLE     PROJECTED
       CURRENT                                            MONITORING
ment                ACTION(S) TO TAKE     that can be                         PARTY for     COMPLETN
       SITUATION                                          PROGRESS to
 #                                       DOCUMENTED                        DELIVERABLE(S)     DATE
                                                         DELIVERABLE(S)

                                                         Criteria based
                                                                            MEASURE
                                                          selection of
                    Institutionalizing                                      Evaluation
                                         Documented      trainees and
                     an evaluation                                          SNNP RHB
   Failure           culture within the
                                          evaluation      trainers
                                                                            Sidama
   to plan                                plans          Training
                     Organization                                            ZHD
                                         Number of       manuals                          Jan
 3 for              Capacity                                               All partners
                                          staff trained  Pre- and post-                    2013
   evalu-            building in                                             working in
                                          on              tests
                     planning and                                            health
   ations                                 evaluation     Cross-
                     implementation                                          programs in
                                          frameworks      checking the
                     of evaluation                                           Sidama
                                                          plan
                                                                             Zone
                                                          documented

 Sidama Zonal Health Department
Questions or Comments?
Next Steps
Thank You!
MEASURE Evaluation is funded by the U.S. Agency for
International Development (USAID) and implemented by the
Carolina Population Center at the University of North Carolina
at Chapel Hill in partnership with Futures Group International,
ICF International, John Snow, Inc., Management Sciences for
Health, and Tulane University. Views expressed in this
presentation do not necessarily reflect the views of USAID or the
U.S. government.

MEASURE Evaluation is the USAID Global Health Bureau's
primary vehicle for supporting improvements in monitoring and
evaluation in population, health and nutrition worldwide.

Self-Assessment of Organizational Capacity in Monitoring & Evaluation

  • 1.
    SELF-ASSESSMENT OF ORGANIZATIONAL CAPACITYIN MONITORING & EVALUATION by SNNP REGIONAL HEALTH BUREAU SIDAMA ZONAL HEALTH DEPARTMENT PRESENTATION of FINDINGS 05 December 2012
  • 2.
    Proposed Time Schedulefor Discussion 10 Minutes Introductions PowerPoint Presentations 20 Minutes Terms & Concepts on: * Capacity Building * Organizational Development * SCORE ME org. self-assessment tool of M&E capacity 30 Minutes SNNP Regional Health Bureau Presentation of Findings from use of SCORE ME 30 Minutes Sidama Zonal Health Department Presentation of Findings from use of SCORE ME 30 Minutes Questions, Comments, Next Steps
  • 3.
    DEFINITIONS OF CAPACITYand CAPACITY BUILDING  CAPACITY: Set of abilities and resources to support a level of desired performance – whether by an individual or an organization of any size  CAPACITY BUILDING: Processes that improve the ability of a person, group, organization, or system to meet objectives and/or to perform better
  • 4.
    CAPACITY BUILDING: SOMETHINGTO THINK ABOUT • Common approach is to provide training, funding, material resources, and technical assistance • Results would be more effective with consideration of other factors influencing performance of an individual or organization  behavioral  cultural  systemic
  • 5.
    MEASURE EVALUATION’S FOCUSin CAPACITY BUILDING Support the ability of its partners to independently and sustainably carry out activities in monitoring and evaluation (M&E) and routine health information systems (RHIS) Phase I (1998 – 2003) Phase III (2009 – 2014) • Design of new tools ** Knowledge management • Data analysis ** Organization development Phase II (2004 – 2009) • Routine health information systems strengthening • Data demand & use • Data quality • M&E technical training
  • 6.
    FOCAL AREAS forCAPACITY BUILDING in M&E Operational Functions: • Management and development of human resources in RHIS and M&E • Material and financial resources, and systems to manage them • Technical RHIS and M&E skills • Communication and facilitation of use of information
  • 7.
    FOCAL AREAS forCAPACITY BUILDING in M&E Leadership and Relationship Building: • Promotion of culture favoring information use • Strategic leadership • Management of stakeholder relations
  • 8.
    MEASURE EVALUATION’s CONCEPTof ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E OD Goal: Improve organization’s effectiveness in managing its own efforts to achieving objectives Strategy: Motivate individuals and groups within an organization to seek and sustain best possible performance
  • 9.
    MEASURE EVALUATION’s CONCEPTof ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E Method — Assist Organization to: • Identify individual and institutional needs for obtaining desired results and levels of achievement • Identify its current strengths and challenges • Increase capacity of those at management and leadership positions to support and champion performance improvement and positive responsiveness to change • Improve M&E performance of organization to regularly assess current strategies, structures, processes, achievements, results
  • 10.
    MEASURE EVALUATION’s CONCEPTof ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E Needs of Organization: • Clarity of organizational vision • Comprehensive strategic planning • Effective organizational structure • Strong governance structure • Strong capacity among leaders for promoting teamwork and managing change • Strong accountability systems (human and financial resource management, inventory control)
  • 11.
    MEASURE EVALUATION’s CONCEPTof ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E Results — Organization is able to Self-Assess and Improve its Accountability Systems for: 1. Planning and executing operational functions and achieving pre-set objectives 2. Actively undertaking problem solving 3. Committing to its own organizational development as ongoing process 4. Learning and sharing knowledge and perceptions with organizations in and across sectors 5. Assessing and accessing means for remaining operationally sustainable and relevant to future needs and demands
  • 12.
    MEASURE EVALUATION’s CONCEPTof ORGANIZATION DEVELOPMENT (OD) to SUPPORT M&E Outcome — Improved organizational management and performance in: • Use of M&E methods and tools • Collection and analysis of routine and strategic information • Use of routine information for program M&E • Use of strategic information for organizational planning • Evidence-based decision making by organization’s leadership and management • Sustainability of all the above performance areas
  • 13.
  • 14.
    Organization’s Functional Capacities for Self-Assessment in M&E Performance • Strategic Planning • Budgeting and Managing Finances • Implementation Planning • Documenting & Reporting of Work Activities & Results for Monitoring Oversight • Documenting & Reporting of Work Activities & Results for Evaluation Assessment • Managing Facilities and Physical Assets • Managing and Developing Staff • Promoting Continuous Quality Improvement
  • 15.
    Features of SCOREME: Tool for Self-Assessment in M&E Performance  Developed as a self-administered tool for an M&E Department/Unit of any agency (government/non- governmental) to appraise its own level of functional capacity in eight areas  Designed so that its use on a periodic basis would promote M&E skills and competencies  Self-assessment in each functional area determined by number of elements by which agency M&E performance meets conditions (with reference made if supporting evidence is available or not)
  • 16.
    Features of SCOREME (cont’d)  Agency can customize the use and wording of M&E performance elements to better suit its purpose for self-assessment in M&E capacity  Agency can select those functional areas of greater interest on which to first focus its capacity building efforts  Agency can develop plans for M&E capacity building that are based on a formalized pre-assessment of its M&E performance
  • 17.
    Introduction of SCOREME to Health Sectors in SNNP Region • Review of content and use of SCORE ME instrument • Organizational and individual self-assessments of M&E capacity, with on-site technical assistance, as required • Formulation of improvement plan for organizational capacity in M&E, as based on self-assessment findings
  • 18.
    SNNP REGIONAL HEALTHBUREAU FUNCTIONAL PROCESSES • CORE Processes – Disease Prevention Services and Good Health Practices Promotion – Curative Health Services – Regulatory Oversight – Public Health Emergency Response Services – HIV/AIDS Preventive Health Services and Disease Control • SUPPORTING Processes – Health Program Planning and Health Program M&E – Disease Diagnoses through Laboratory Services – Medical Research – Human Resources Management – Financial Administration
  • 19.
    Memorable Quotes  "Measurementis the first step that leads to control and eventually to improvement. If you can't measure something, you can't understand it. If you can't understand it, you can't control it. If you can't control it, you can't improve it." — H. James Harrington  "What gets measured gets done, what gets measured and fed back gets done well, what gets rewarded gets repeated." — John E. Jones  "Without a standard there is no logical basis for making a decision or taking action." — Joseph M. Juran  "Nothing changes until you change; everything changes once you change." — posted at Sidama Zonal Health Department
  • 20.
    SCORE ME Self-Assessmentof M&E Capacity SNNP Regional Health Bureau 28-29 November 2012
  • 21.
    Organization’s Functional Capacities for Self-Assessment in M&E Performance A Strategic Planning B Budgeting and Managing Finances C Implementation Planning D Documenting/Reporting Work Activities/Results for Monitoring Oversight E Documenting/Reporting Work Activities/Results for Evaluation Assessment F Managing Facilities and Physical Assets G Managing and Developing Staff H Promoting Continuous Quality Improvement SNNP Regional Health Bureau
  • 22.
    D Documenting/Reporting Work Activities/Results for Monitoring Oversight Elements of Capacity Condition Building/Organizational Met? Evidence Available? Development Performance in If “Yes”, Specify M&E by Organization/Unit Check  Unit has written policies / procedures and docu- mented evidence for monitoring on a quarterly or more frequent basis: We have: written business process re-engineering documents; facility standard documents; expenditure reports; 1. Work inputs  woreda-based plans; balanced score card; standard reporting format; standard check-list; routine performance review; database generated summary data; program-based reporting Information, Education, Communication/ Behavior Change Communication design, distribution, dissemination; integrated 2. Work activities  supportive supervision feedback; quarterly HMIS review feedback to zones SNNP Regional Health Bureau
  • 23.
    D Documenting/Reporting Work Activities/Results for Monitoring Oversight Elements of Capacity Condition Building / Organizational Met? Evidence Available? Development Performance in If “Yes”, Specify M&E by Organization / Unit Check  Review guidelines; process maturity assessment; standard integrated supportive supervision; standard guidelines for 3. Work processes  reviewing, licensing, and inspecting health facilities; different service delivery guidelines; laboratory external quality assurance Quarterly feedback on program-specific activities; monthly, quarterly, semi-annual, and annual reports (physical and 4. Work outputs  financial); payroll reports; attendance sheets; various models on in-and-out assets; epidemic monitoring charts; expanded program for immunizations monitoring charts SNNP Regional Health Bureau
  • 24.
    D Documenting/Reporting forMonitoring Oversight Unit has written Condition policies/procedures and Met? Evidence Available? documented evidence for If “Yes”, Specify responsiveness to Check  ensuring: 5. Collection of all  required work data 6. Timely collection and transmission of all  required work data See the abovelisted justifications. Performance review team, guidelines, reporting time frame, 7. High quality of all  LQAS needs further improvement required work data 8. Analysis of all X required work data SNNP Regional Health Bureau
  • 25.
    D Documenting/Reporting forMonitoring Oversight Unit has written Condition policies/procedures and Met? Evidence Available? documented evidence for If “Yes”, Specify responsiveness to ensuring: Check  Board minutes book for hospitals; guidelines and manuals for HIV/AIDS; prevention board and council Management 9. Unit’s leadership/Board  standards for woreda health offices, zonal health Department, and Regional Health Bureau Management standards and management minutes book for: 10. Unit’s management  hospitals, zonal health department, district health offices and health centers Procedures for fund allocations, fund liquidation; project 11. Unit’s funders and management manual; MOA, standard reporting, formal  supporters (financial and physical); standard checklist for project appraisal 12. Unit’s target population Community-facility forum guidelines; human development  army guidelines representatives SNNP Regional Health Bureau
  • 26.
    D Documenting/Reporting forMonitoring Oversight Unit has written Condition policies/procedures and Met? Evidence Available? documented evidence for If “Yes”, Specify regular review and use of Check  work data findings by: Management standards 13. Unit’s leadership/Board  Board minutes book Management standards 14. Unit’s management  Management minutes book SNNP Regional Health Bureau
  • 27.
    D Documenting/Reporting forMonitoring Oversight Scoring from Self-Assessment Findings Total Number of 13 / 4 or 5 or 6 7 or 8 9 or 10 or 12 or Conditions Met  14 fewer 11 more 1 2 3 4 5 SNNP Regional Health Bureau
  • 28.
    D Documenting/Reporting forMonitoring Oversight Corrective Action Plan based on Self-Assessment Findings MEANS for Ele- DELIVERABLE(S) RESPONSIBLE PROJECTED CURRENT ACTION(S) TO MONITORING ment that can be PARTY for COMPLETN SITUATION TAKE PROGRESS to # DOCUMENTED DELIVERABLE(S) DATE DELIVERABLE(S) No procedure or Availability of Develop Planning, M&E guidelines Procedures, document at each By end of 8 for analysis procedures or guidelines level (of health care Process Owner May 2013 guidelines and partners of all administration) required data SNNP Regional Health Bureau
  • 29.
    E Documenting/Reporting Work Activities/Results for Evaluation Assessment Unit has written policies/procedures and documented evidence for having Condition evaluated for work effectiveness and Met? Evidence Available? efficiency the projections that had If “Yes”, Specify been set in Annual Budgets and Check  Implementation Plans: Assignment of personnel based on BPR 1. Budgeting and deploying inputs  document; allocated funds (budgeting) Process maturity evaluation of evaluation for- 2. Undertaking work processes  mat; BPR & BSC implementation manuals; planning, monitoring, and evaluation processes 3. Completing planned activities X -- 4. Generating projected outputs X -- 5. Meeting pre-set objectives X -- 6. Achieving desired outcomes  Operationalization of health research process 7. Contributing to desired impact  -- SNNP Regional Health Bureau
  • 30.
    E Documenting/Reporting forEvaluation Assessment Condition Unit has documented evidence for Met? Evidence Available? allocation of budget and If “Yes”, Specify other resources for: Check  8. Collection of all required work Resource mobilization for HMIS; woreda-based  planning for research data and information 9. Quality assessments of work X -- data 10. Quality assessments of work X -- performance 11. Analyses of work data X -- SNNP Regional Health Bureau
  • 31.
    E Documenting/Reporting forEvaluation Assessment Condition Unit has documented evidence for Met? Evidence Available? allocation of budget and If “Yes”, Specify other resources for: Check  12. Reporting on work data to Monthly, quarterly, semi-annual and annual  reports concerned stakeholders 13. Using the findings from reports for the improvement Annual performance used for evidence-based  planning and written feedback of planning and implementation Availability of research staff to do research and 14.Conducting research on ways technology transfer sub-process and to promote work  disseminate research results; rapid effectiveness and efficiency assessment conducted on data utilization for decision-making SNNP Regional Health Bureau
  • 32.
    E Documenting/Reporting forEvaluation Assessment Scoring from Self-Assessment Findings Total Number of 8/ 4 or 5 or 6 7 or 8 9 or 10 or 12 or Conditions Met  14 fewer 11 more 1 2 3 4 5 SNNP Regional Health Bureau
  • 33.
    E Documenting/Reporting forEvaluation Assessment Corrective Action Plan based on Self-Assessment Findings MEANS for Ele- DELIVERABLE(S) RESPONSIBLE PROJECTED CURRENT ACTION(S) TO MONITORING ment that can be PARTY for COMPLETN SITUATION TAKE PROGRESS to # DOCUMENTED DELIVERABLE(S) DATE DELIVERABLE(S) Amount of budget mobilized Financial reports Inadequate Amount of allocation for Revise Response letters budget from partners SNNP RHB quality resource allocated allocations Reports on assessments, MEASURE June 1 performance Resource quality Evaluation 2013 Develop assessments reviews, and mapping resource and performance Partners analysis of document mapping reviews developed work data conducted Reports on work data analysis SNNP Regional Health Bureau
  • 34.
    E Documenting/Reporting forEvaluation Assessment Corrective Action Plan based on Self-Assessment Findings MEANS for Ele- DELIVERABLE(S) RESPONSIBLE PROJECTED CURRENT ACTION(S) TO MONITORING ment that can be PARTY for COMPLETN SITUATION TAKE PROGRESS to # DOCUMENTED DELIVERABLE(S) DATE DELIVERABLE(S) Terms of reference Skill gap in Capacity End of developing Number of trained Selection of building training January evaluation M&E Officers and trainees for basic MEASURE 2013 other focal frame work for concepts of Evaluation (training) 2 persons Attendance lists evaluation evaluation for activities, out- M&E Officers SNNP RHB May 2013 M&E framework Training documents puts, & pre-set and other focal M&E developed persons framework objectives Pre- & post-test evaluations SNNP Regional Health Bureau
  • 35.
  • 36.
    SCORE ME Self-Assessmentof M&E Capacity Sidama Zonal Health Department 01 December 2012
  • 37.
    Organization’s Functional Capacities for Self-Assessment in M&E Performance A Strategic Planning B Budgeting and Managing Finances C Implementation Planning D Documenting/Reporting Work Activities/Results for Monitoring Oversight E Documenting/Reporting Work Activities/Results for Evaluation Assessment F Managing Facilities and Physical Assets G Managing and Developing Staff H Promoting Continuous Quality Improvement Sidama Zonal Health Department
  • 38.
    D Documenting/Reporting Work Activities/Results for Monitoring Oversight Condition Elements of Capacity Building / Met? Evidence Available? Organizational Development Performance If “Yes”, Specify in M&E by Organization / Unit Check  Unit has written policies/procedures and documented evidence for monitoring on a quarterly or more frequent basis:  Strategic plans 1. Work inputs   Woreda-based plans  Standard guidelines for different 2. Work activities  programs (TB, HIV, RH, TB/HIV collaborative activities)  Performance reports 3. Work processes   Business process re-engineering  Balanced score card   Standard checklists 4. Work outputs  E-HMIS Summary reports Sidama Zonal Health Department
  • 39.
    D Documenting/Reporting forMonitoring Oversight Condition Unit has written policies/procedures and Met? Evidence Available? documented evidence for If “Yes”, Specify responsiveness to ensuring: Check  5. Collection of all required work  data 6. Timely collection and  HMIS tools and guidelines transmission of all required work   Standard reporting schedules  HMIS minutes book data  Performance Review Team minutes book 7. High quality of all required work  Analysis of routine performance X data reports from respective woredas, as well as within the Organization (unit) 8. Analysis of all required work data  Sidama Zonal Health Department
  • 40.
    D Documenting/Reporting forMonitoring Oversight Condition Unit has written policies/procedures and Met? Evidence Available? documented evidence for If “Yes”, Specify responsiveness to ensuring: Check  9. Unit’s leadership/Board   Management minutes book  Management standards 10. Unit’s management   Regular monthly/quarterly 11. Unit’s funders and supporters  reporting, including review meetings with concerned bodies 12. Unit’s target population  Contractual agreements with  partners representatives  Standard checklists 13. Unit’s leadership/Board   Management minutes book  Management standards 14. Unit’s management  Sidama Zonal Health Department
  • 41.
    D Documenting/Reporting forMonitoring Oversight Scoring from Self-Assessment Findings Total Number of 13 / 4 or 5 or 6 7 or 8 9 or 10 or 12 or Conditions Met  14 fewer 11 more 1 2 3 4 5 Sidama Zonal Health Department
  • 42.
    D Documenting/Reporting forMonitoring Oversight Corrective Action Plan based on Self-Assessment Findings MEANS for Ele- DELIVERABLE(S) RESPONSIBLE PROJECTED CURRENT MONITORING ment ACTION(S) TO TAKE that can be PARTY for COMPLETN SITUATION PROGRESS to # DOCUMENTED DELIVERABLE(S) DATE DELIVERABLE(S)  Criteria based  Capacity selection of building on  Number of trainees and data manage- staff trained  MEASURE  Jan 2013 trainers ment on evaluation Evaluation (capacity  Training  Appropriate framework  SNNP RHB building) manuals Low technology for  Number of  Sidama ZHD  Jan 2013  Pre- and post- data manage- offline HMIS  All partners (techno- 7 quality ment (software data tests working in logy) data  Available data analysis management health  April technology for at zonal as centers programs in 2013 offline data well as woreda  Established Sidama (integra- management levels) One Report Zone tion)  Established  Data System One Report integration System Sidama Zonal Health Department
  • 43.
    E Documenting/Reporting Work Activities/Results for Evaluation Assessment Unit has written policies/procedures and Condition documented evidence for having evaluated Met? Evidence Available? for work effectiveness and efficiency If “Yes”, Specify the projections that had been set in Annual Check  Budgets and Implementation Plans: 1. Budgeting and deploying inputs X -- 2. Undertaking work processes  Performance Report 3. Completing planned activities X -- 4. Generating projected outputs X -- 5. Meeting pre-set objectives X -- 6. Achieving desired outcomes X -- 7. Contributing to desired impact X -- Sidama Zonal Health Department
  • 44.
    E Documenting/Reporting forEvaluation Assessment Condition Unit has documented evidence for Met? Evidence Available? allocation of budget and If “Yes”, Specify other resources for: Check  8. Collection of all required work   Performance reports data and information 9. Quality assessments of work X -- data 10. Quality assessments of work X -- performance  Analysis of data from performance reports 11. Analyses of work data   Analysis of data from project evaluations Sidama Zonal Health Department
  • 45.
    E Documenting/Reporting forEvaluation Assessment Condition Unit has documented evidence for Met? Evidence Available? allocation of budget and If “Yes”, Specify other resources for: Check   Dissemination to community representatives 12. Reporting on work data to   Dissemination to partners concerned stakeholders  Dissemination/communication within the Organization 13. Using the findings from  Reviewing performance reports by management teams reports for the improvement   Reviewing performance reports by of planning and core-process/supporting process implementation teams 14.Conducting research on ways to promote work X -- effectiveness and efficiency Sidama Zonal Health Department
  • 46.
    E Documenting/Reporting forEvaluation Assessment Scoring from Self-Assessment Findings Total Number of 5/ 4 or 5 or 6 7 or 8 9 or 10 or 12 or Conditions Met  14 fewer 11 more 1 2 3 4 5 Sidama Zonal Health Department
  • 47.
    E Documenting/Reporting forEvaluation Assessment Corrective Action Plan based on Self-Assessment Findings MEANS for Ele- DELIVERABLE(S) RESPONSIBLE PROJECTED CURRENT ACTION(S) TO MONITORING ment that can be PARTY for COMPLETN SITUATION TAKE PROGRESS to # DOCUMENTED DELIVERABLE(S) DATE DELIVERABLE(S)  Feedback  MEASURE following Evaluation budget  SNNP RHB Resource  Resource  Amount of approval  Sidama ZHD  Jan 1 (financial) (financial) budget  Amount of  All partners 2013 scarcity scarcity allocated budget really working in spent for health evaluation programs in purposes Sidama Zone Sidama Zonal Health Department
  • 48.
    E Documenting/Reporting forEvaluation Assessment Corrective Action Plan based on Self-Assessment Findings MEANS for Ele- DELIVERABLE(S) RESPONSIBLE PROJECTED CURRENT MONITORING ment ACTION(S) TO TAKE that can be PARTY for COMPLETN SITUATION PROGRESS to # DOCUMENTED DELIVERABLE(S) DATE DELIVERABLE(S)  Criteria based  MEASURE selection of  Institutionalizing Evaluation  Documented trainees and an evaluation  SNNP RHB Failure culture within the evaluation trainers  Sidama to plan plans  Training Organization ZHD  Number of manuals  Jan 3 for  Capacity  All partners staff trained  Pre- and post- 2013 evalu- building in working in on tests planning and health ations evaluation  Cross- implementation programs in frameworks checking the of evaluation Sidama plan Zone documented Sidama Zonal Health Department
  • 49.
  • 50.
  • 51.
  • 52.
    MEASURE Evaluation isfunded by the U.S. Agency for International Development (USAID) and implemented by the Carolina Population Center at the University of North Carolina at Chapel Hill in partnership with Futures Group International, ICF International, John Snow, Inc., Management Sciences for Health, and Tulane University. Views expressed in this presentation do not necessarily reflect the views of USAID or the U.S. government. MEASURE Evaluation is the USAID Global Health Bureau's primary vehicle for supporting improvements in monitoring and evaluation in population, health and nutrition worldwide.
