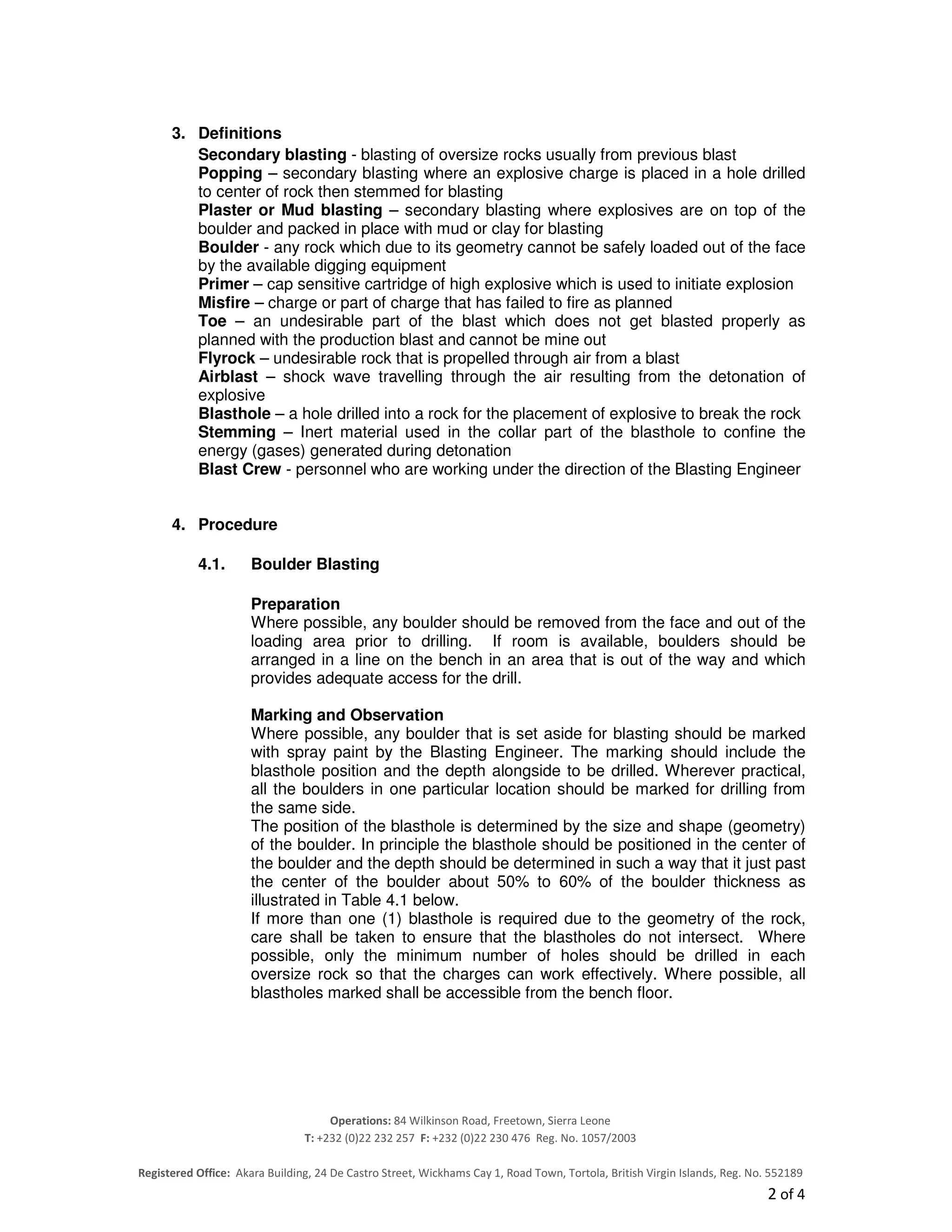

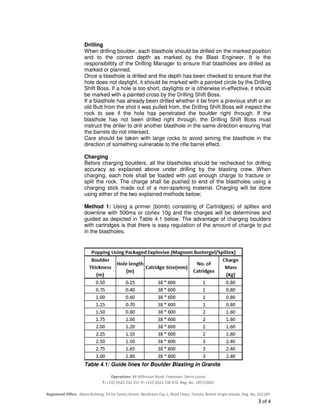

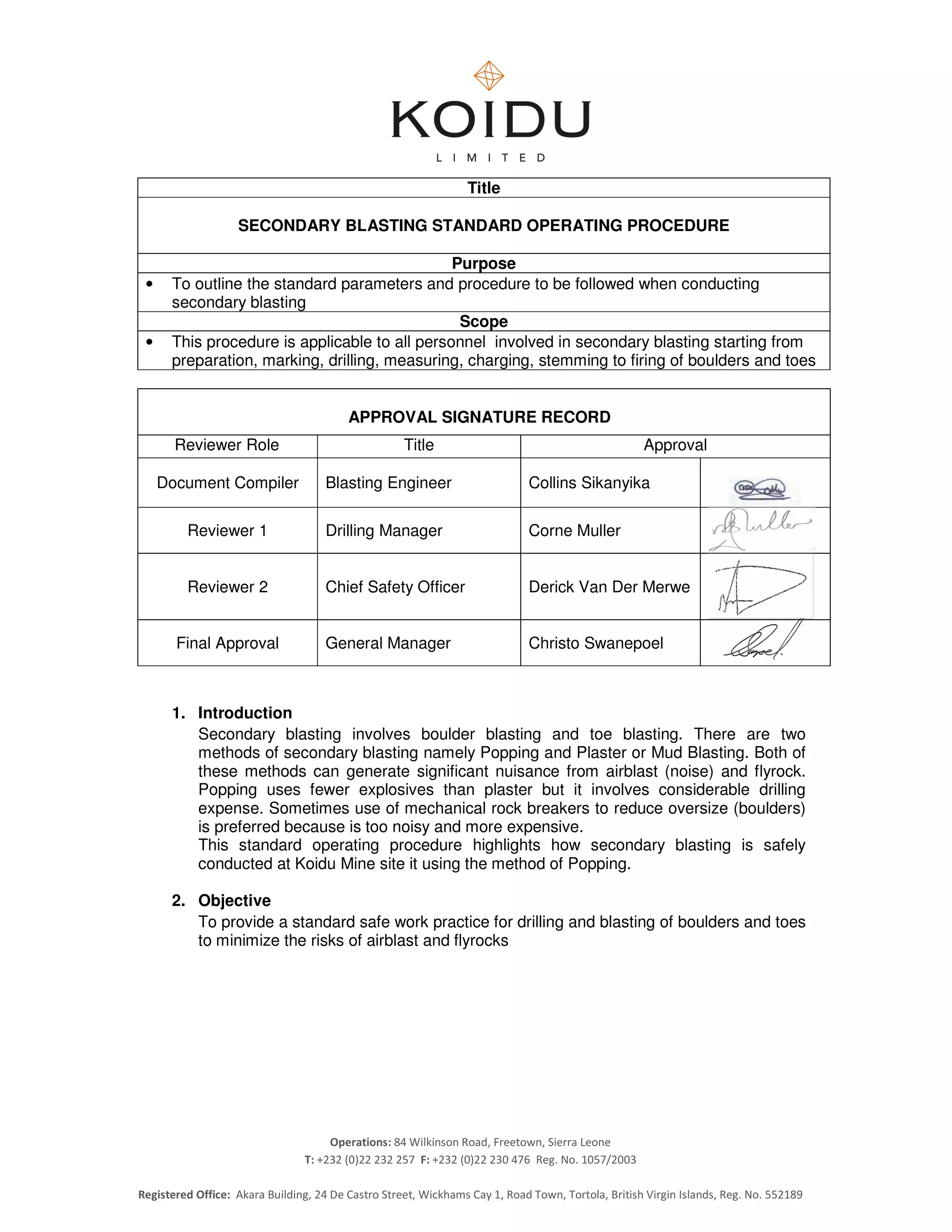

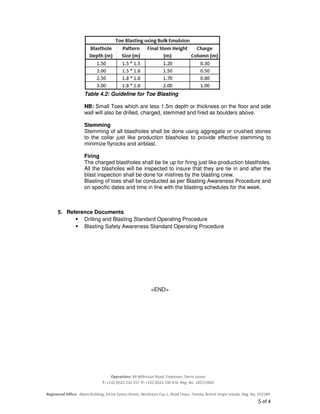

This document outlines standard operating procedures for secondary blasting at a mine site in Sierra Leone. It describes two methods of secondary blasting - popping and plaster/mud blasting. The procedure highlights how to safely conduct popping for boulder and toe blasting. It details steps for preparation, marking, drilling, charging, stemming, and firing of boulders and toes. Guidelines are provided for determining blasthole positions, depths, and explosive charges based on the size and geometry of boulders and average depths of toes. The objective is to break oversized rocks and toes using the minimum explosive charge while minimizing risks of airblast and flyrocks.
