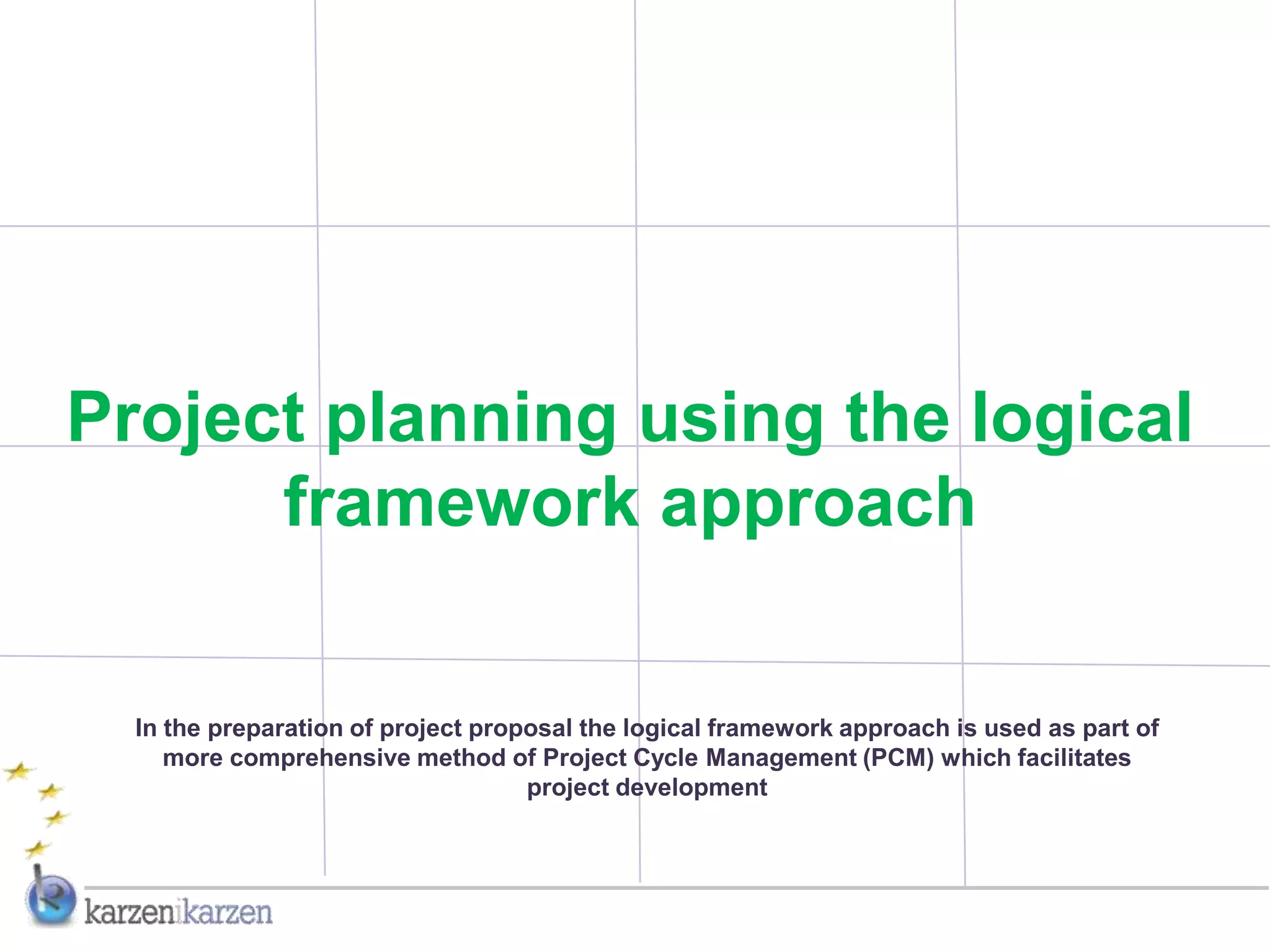

Project planning using the logical
      framework approach

  In the preparation of project proposal the logical framework approach is used as part of
     more comprehensive method of Project Cycle Management (PCM) which facilitates
                                    project development

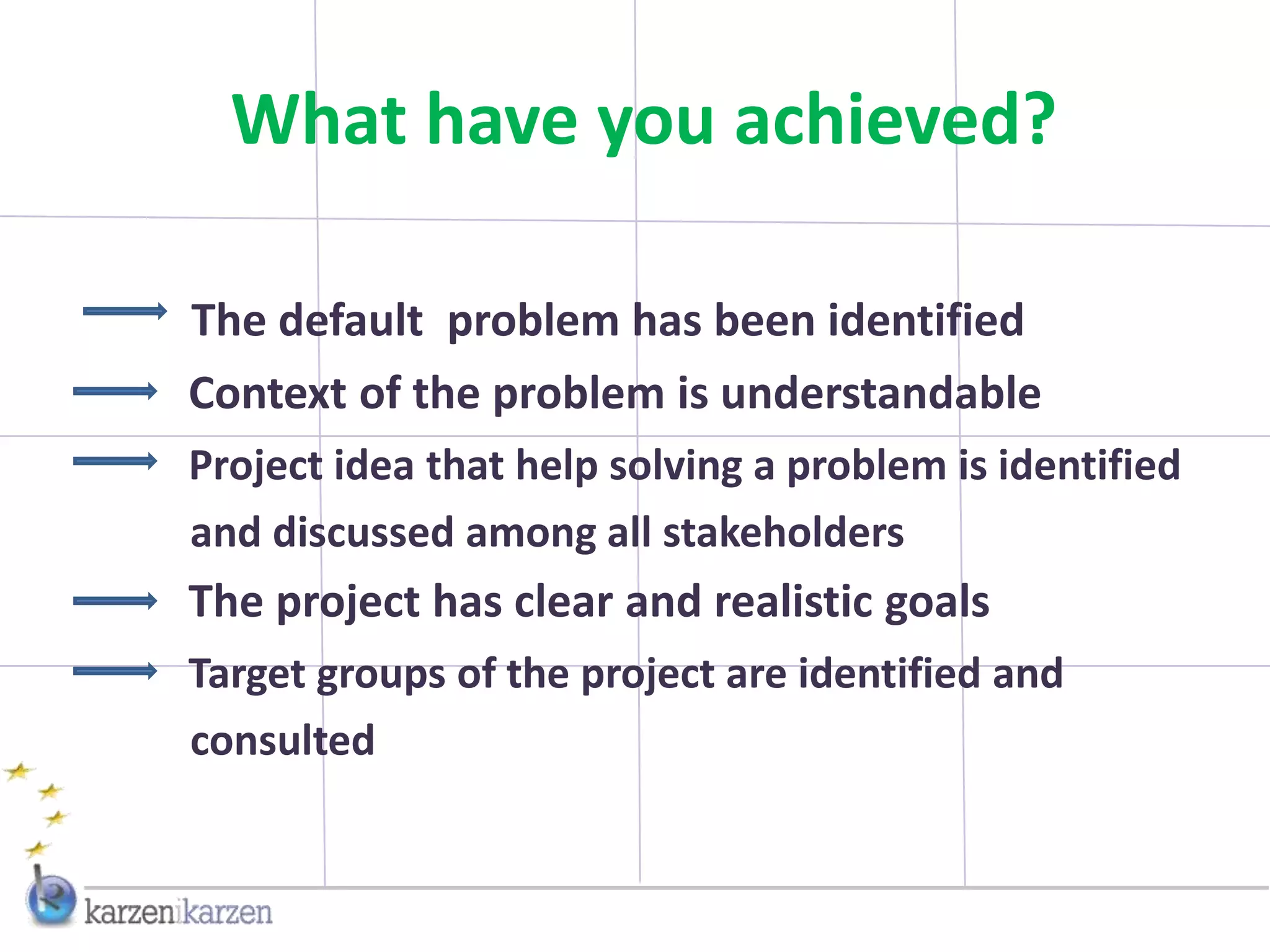

What have you achieved?

The default problem has been identified
Context of the problem is understandable
Project idea that help solving a problem is identified
and discussed among all stakeholders
The project has clear and realistic goals
Target groups of the project are identified and
consulted

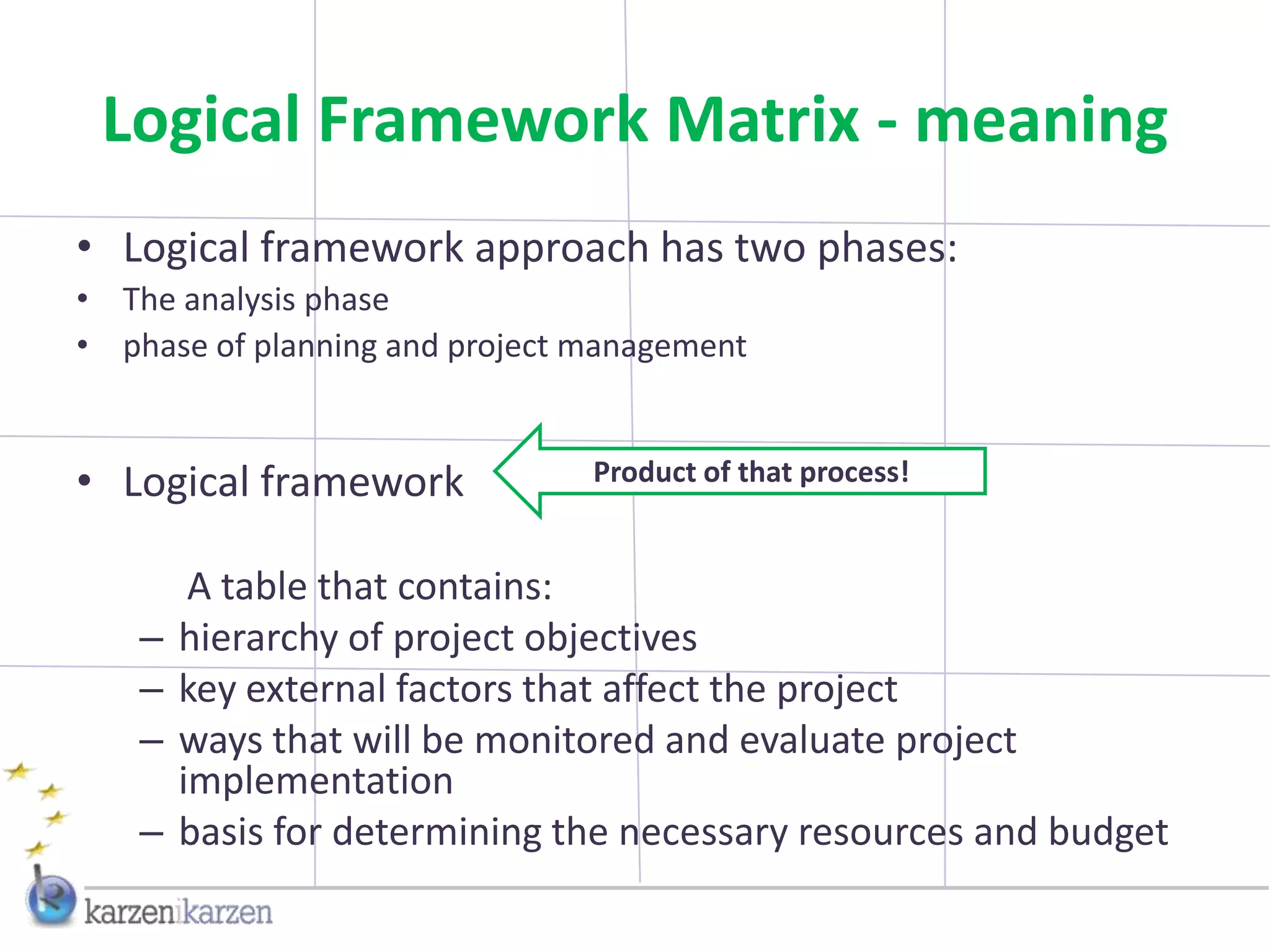

Logical Framework Matrix - meaning
• Logical framework approach has two phases:
• The analysis phase
• phase of planning and project management

• Logical framework             Product of that process!

        A table that contains:
   –   hierarchy of project objectives
   –   key external factors that affect the project
   –   ways that will be monitored and evaluate project
       implementation
   –   basis for determining the necessary resources and budget
Order of logical framework
          creation

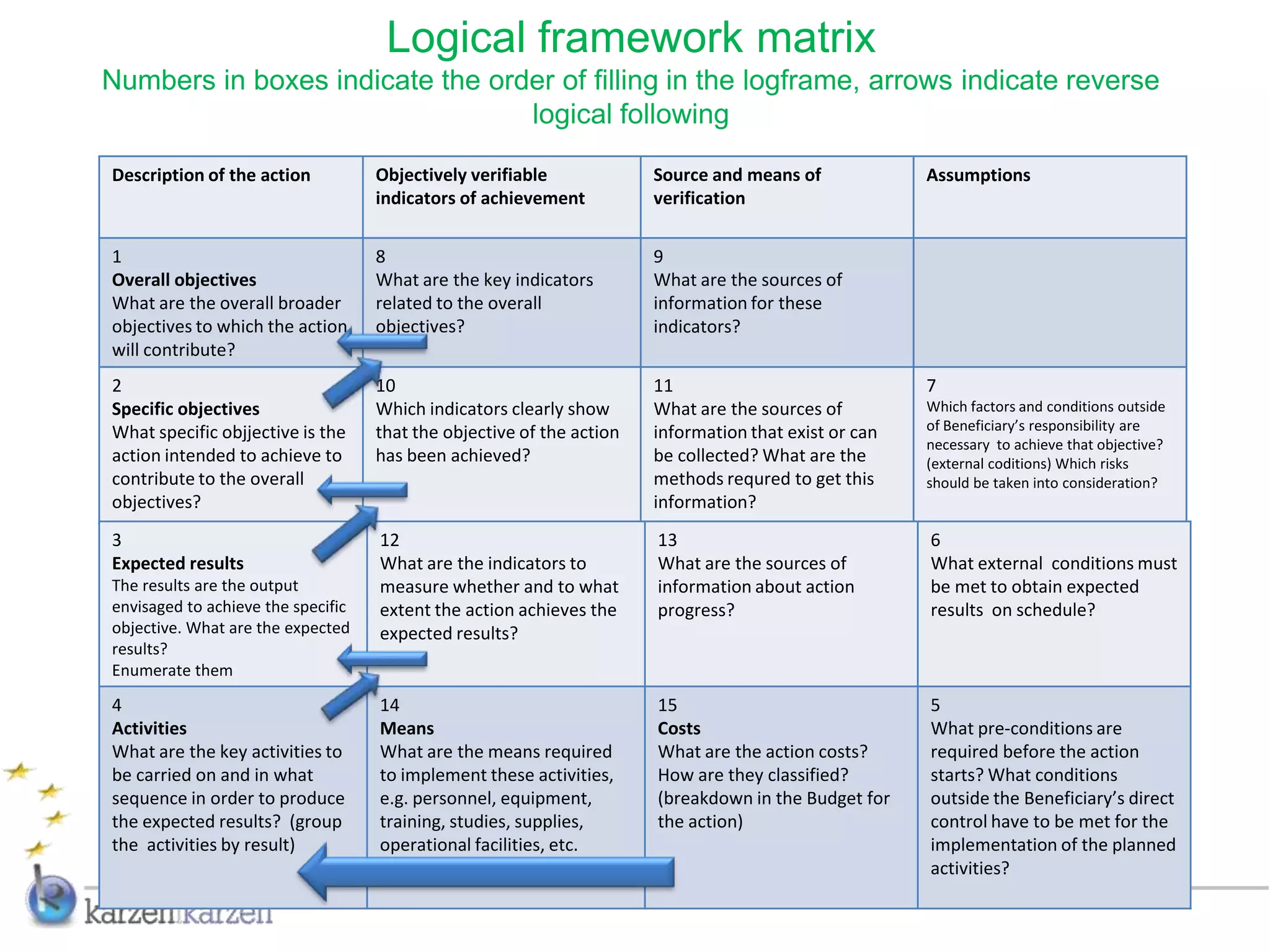

Logical framework matrix
Numbers in boxes indicate the order of filling in the logframe, arrows indicate reverse
                                 logical following

Description of the action           Objectively verifiable             Source and means of             Assumptions
                                    indicators of achievement          verification

1                                   8                                  9
Overall objectives                  What are the key indicators        What are the sources of
What are the overall broader        related to the overall             information for these
objectives to which the action      objectives?                        indicators?
will contribute?
2                                   10                                 11                              7
Specific objectives                 Which indicators clearly show      What are the sources of         Which factors and conditions outside
What specific objjective is the     that the objective of the action   information that exist or can   of Beneficiary’s responsibility are
                                                                                                       necessary to achieve that objective?
action intended to achieve to       has been achieved?                 be collected? What are the      (external coditions) Which risks
contribute to the overall                                              methods requred to get this     should be taken into consideration?
objectives?                                                            information?
3                                   12                                 13                              6
Expected results                    What are the indicators to         What are the sources of         What external conditions must
The results are the output          measure whether and to what        information about action        be met to obtain expected
envisaged to achieve the specific   extent the action achieves the     progress?                       results on schedule?
objective. What are the expected    expected results?
results?
Enumerate them

4                                   14                                 15                              5
Activities                          Means                              Costs                           What pre-conditions are
What are the key activities to      What are the means required        What are the action costs?      required before the action
be carried on and in what           to implement these activities,     How are they classified?        starts? What conditions
sequence in order to produce        e.g. personnel, equipment,         (breakdown in the Budget for    outside the Beneficiary’s direct
the expected results? (group        training, studies, supplies,       the action)                     control have to be met for the
the activities by result)           operational facilities, etc.                                       implementation of the planned
                                                                                                       activities?

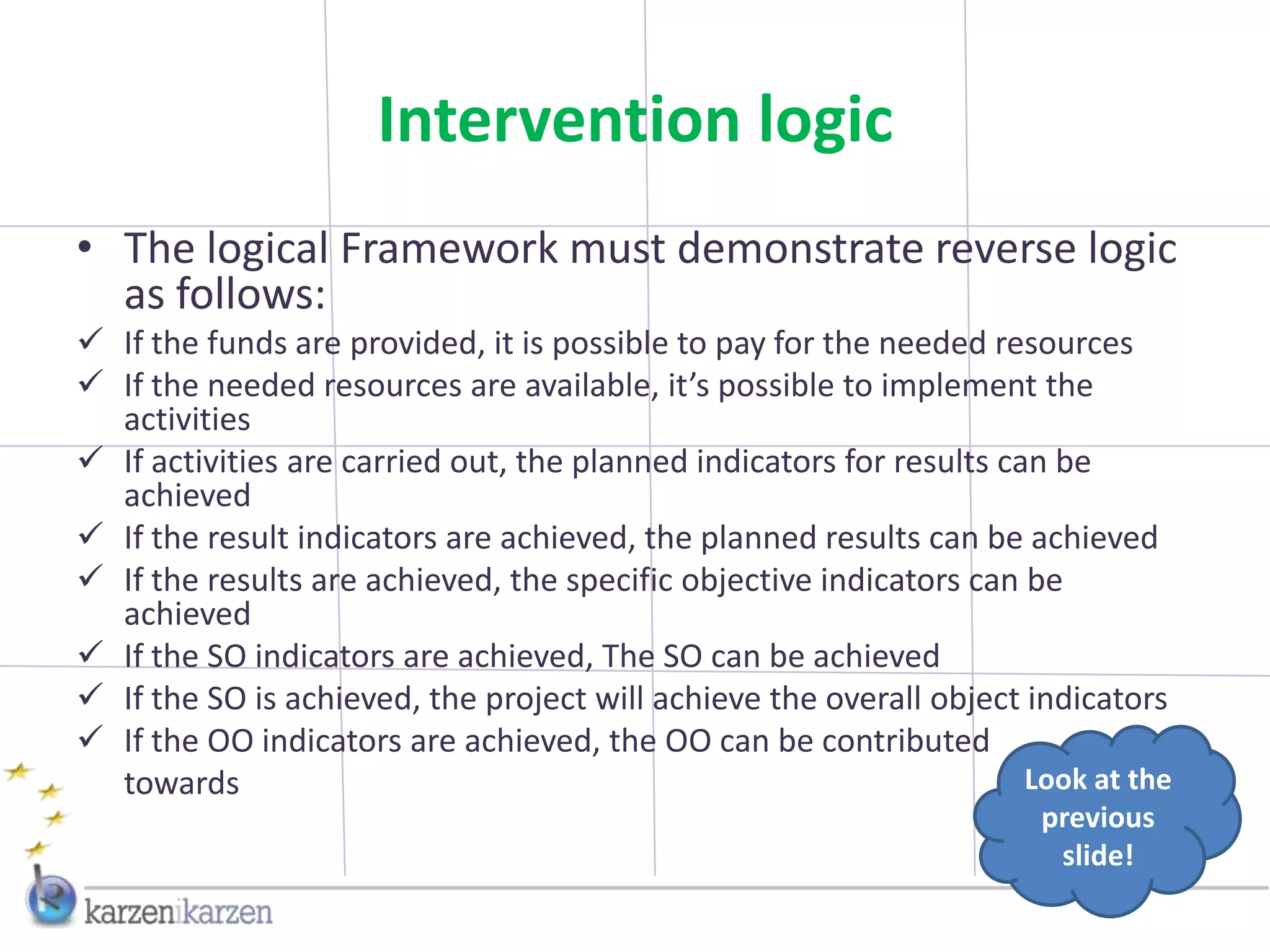

Intervention logic
• The logical Framework must demonstrate reverse logic
  as follows:
 If the funds are provided, it is possible to pay for the needed resources
 If the needed resources are available, it’s possible to implement the
  activities
 If activities are carried out, the planned indicators for results can be
  achieved
 If the result indicators are achieved, the planned results can be achieved
 If the results are achieved, the specific objective indicators can be
  achieved
 If the SO indicators are achieved, The SO can be achieved
 If the SO is achieved, the project will achieve the overall object indicators
 If the OO indicators are achieved, the OO can be contributed
  towards                                                             Look at the
                                                                       previous
                                                                        slide!

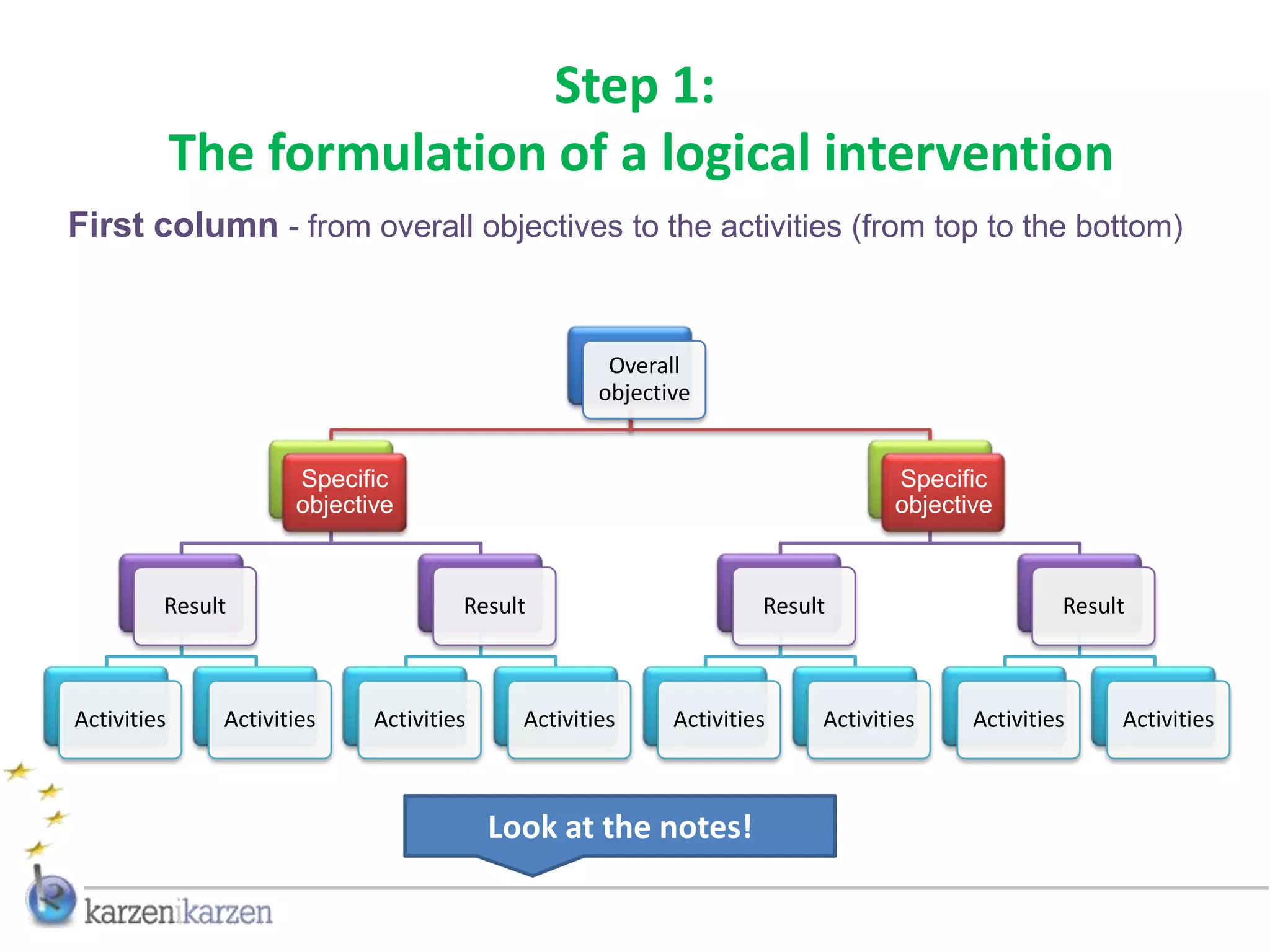

Step 1:
             The formulation of a logical intervention
First column - from overall objectives to the activities (from top to the bottom)

                                                     Overall
                                                    objective

                      Specific                                                  Specific
                      objective                                                 objective

         Result                       Result                        Result                      Result

Activities     Activities    Activities     Activities     Activities    Activities    Activities    Activities

                                          Look at the notes!

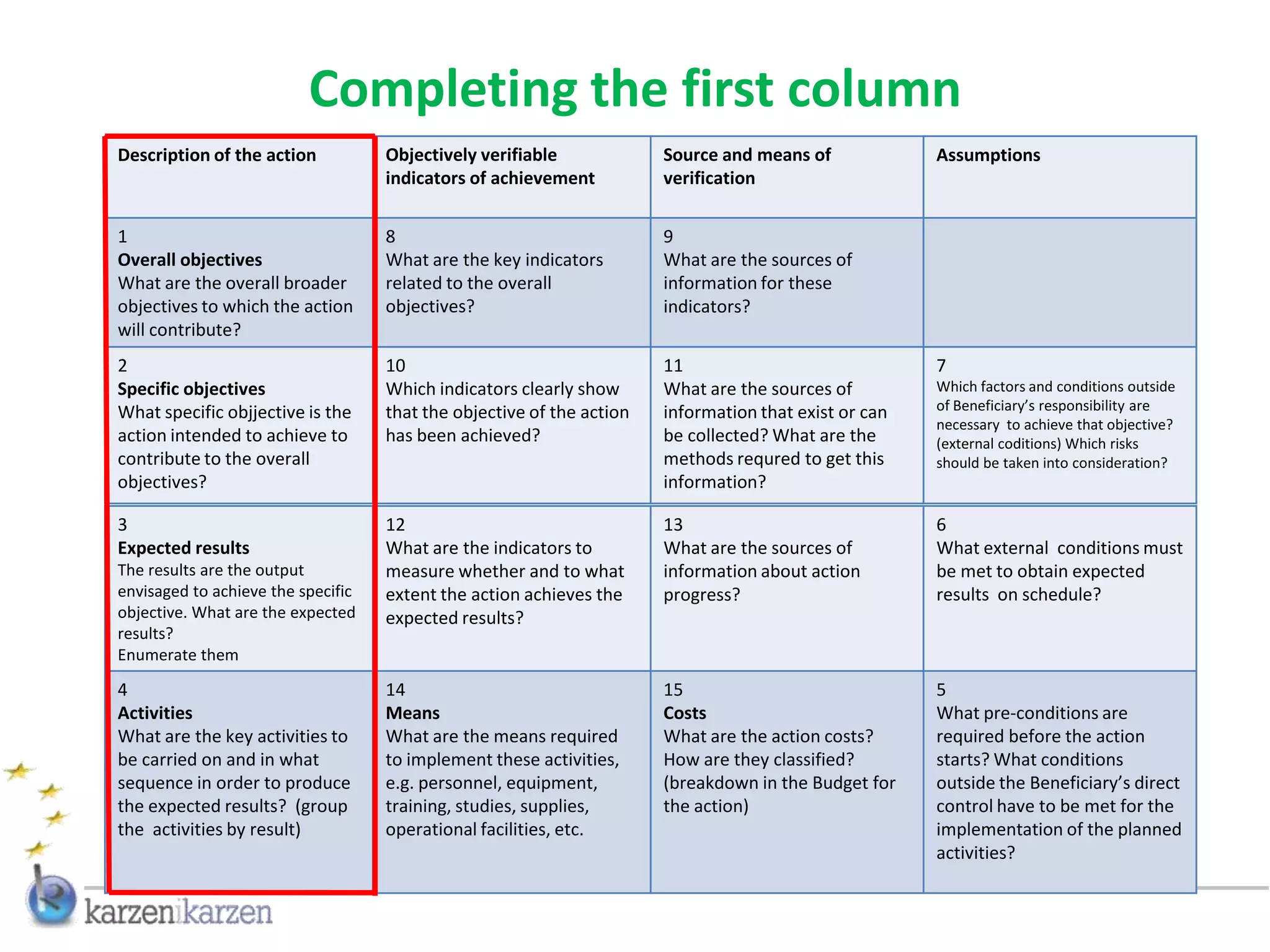

Completing the first column
Description of the action           Objectively verifiable             Source and means of             Assumptions
                                    indicators of achievement          verification

1                                   8                                  9
Overall objectives                  What are the key indicators        What are the sources of
What are the overall broader        related to the overall             information for these
objectives to which the action      objectives?                        indicators?
will contribute?
2                                   10                                 11                              7
Specific objectives                 Which indicators clearly show      What are the sources of         Which factors and conditions outside
What specific objjective is the     that the objective of the action   information that exist or can   of Beneficiary’s responsibility are
                                                                                                       necessary to achieve that objective?
action intended to achieve to       has been achieved?                 be collected? What are the      (external coditions) Which risks
contribute to the overall                                              methods requred to get this     should be taken into consideration?
objectives?                                                            information?

3                                   12                                 13                              6
Expected results                    What are the indicators to         What are the sources of         What external conditions must
The results are the output          measure whether and to what        information about action        be met to obtain expected
envisaged to achieve the specific   extent the action achieves the     progress?                       results on schedule?
objective. What are the expected    expected results?
results?
Enumerate them

4                                   14                                 15                              5
Activities                          Means                              Costs                           What pre-conditions are
What are the key activities to      What are the means required        What are the action costs?      required before the action
be carried on and in what           to implement these activities,     How are they classified?        starts? What conditions
sequence in order to produce        e.g. personnel, equipment,         (breakdown in the Budget for    outside the Beneficiary’s direct
the expected results? (group        training, studies, supplies,       the action)                     control have to be met for the
the activities by result)           operational facilities, etc.                                       implementation of the planned
                                                                                                       activities?

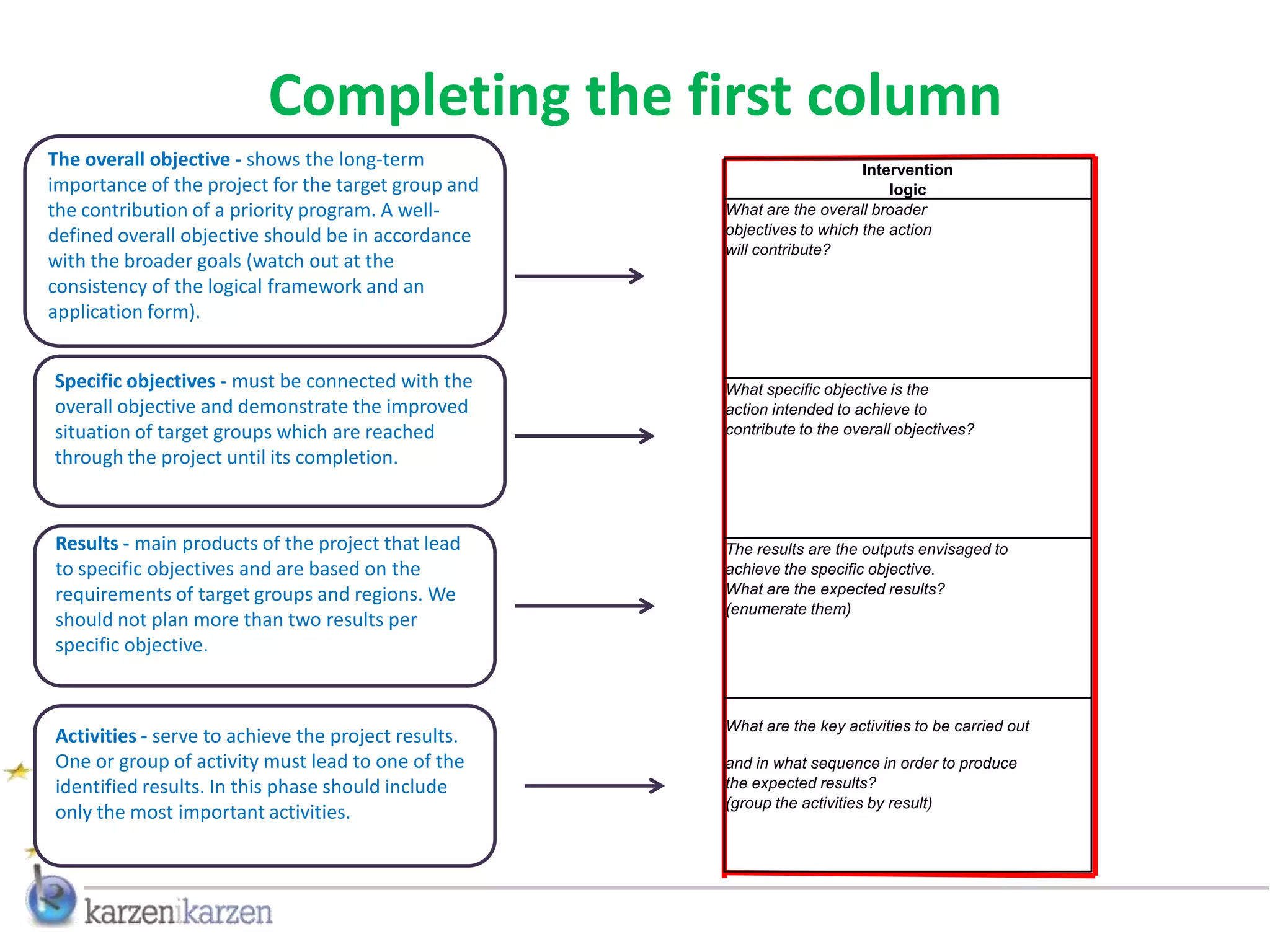

Completing the first column
The overall objective - shows the long-term                              Intervention
importance of the project for the target group and                           logic
the contribution of a priority program. A well-      What are the overall broader
defined overall objective should be in accordance    objectives to which the action
                                                     will contribute?
with the broader goals (watch out at the
consistency of the logical framework and an
application form).

Specific objectives - must be connected with the     What specific objective is the
overall objective and demonstrate the improved       action intended to achieve to
situation of target groups which are reached         contribute to the overall objectives?
through the project until its completion.

Results - main products of the project that lead     The results are the outputs envisaged to
to specific objectives and are based on the          achieve the specific objective.
requirements of target groups and regions. We        What are the expected results?
                                                     (enumerate them)
should not plan more than two results per
specific objective.

                                                     What are the key activities to be carried out
Activities - serve to achieve the project results.
One or group of activity must lead to one of the     and in what sequence in order to produce
identified results. In this phase should include     the expected results?
                                                     (group the activities by result)
only the most important activities.

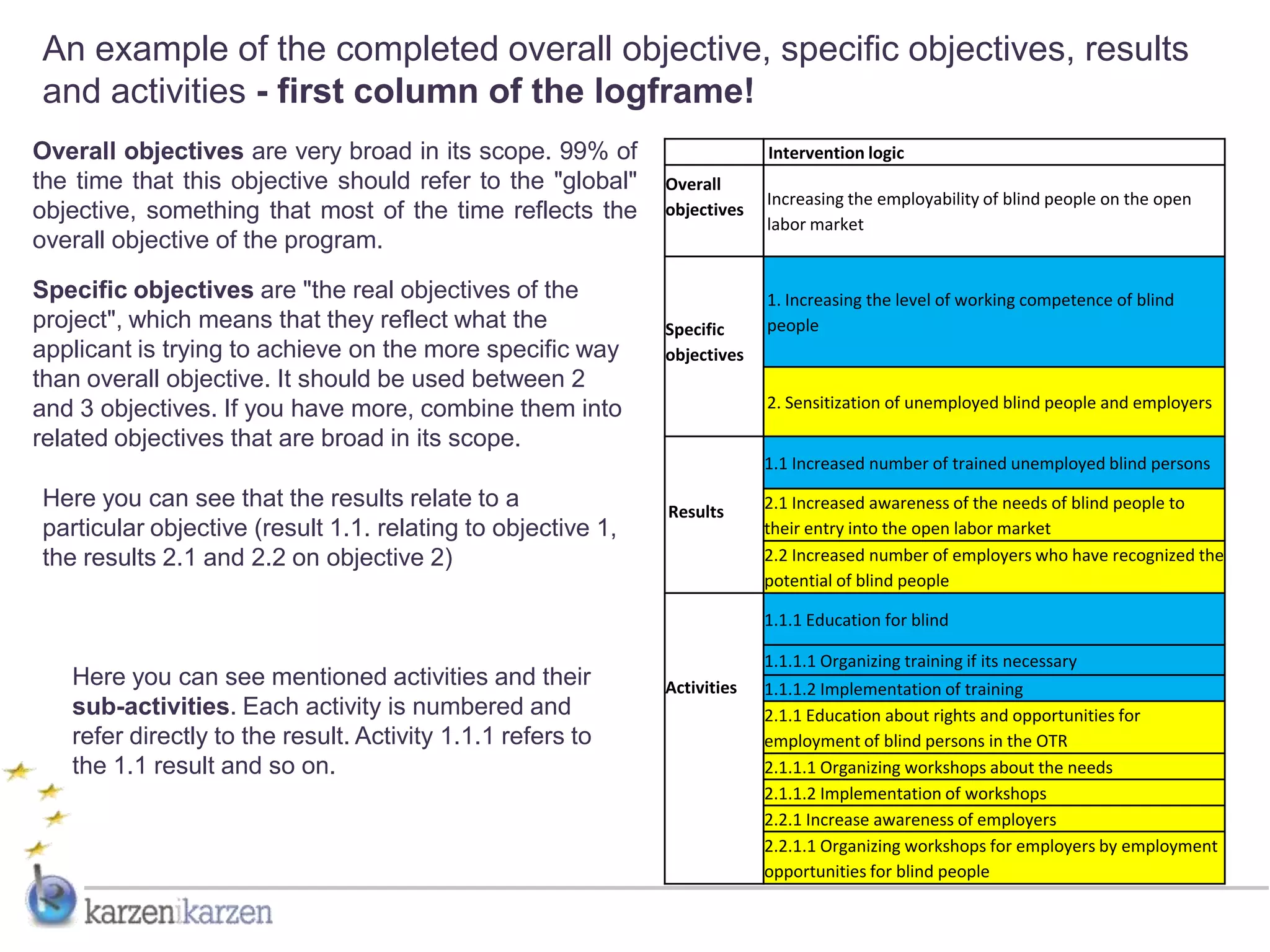

An example of the completed overall objective, specific objectives, results
and activities - first column of the logframe!
Overall objectives are very broad in its scope. 99% of                    Intervention logic
the time that this objective should refer to the "global"    Overall
                                                                          Increasing the employability of blind people on the open
objective, something that most of the time reflects the      objectives
                                                                          labor market
overall objective of the program.

Specific objectives are "the real objectives of the                       1. Increasing the level of working competence of blind
project", which means that they reflect what the             Specific     people
applicant is trying to achieve on the more specific way      objectives
than overall objective. It should be used between 2
and 3 objectives. If you have more, combine them into                     2. Sensitization of unemployed blind people and employers

related objectives that are broad in its scope.
                                                                          1.1 Increased number of trained unemployed blind persons
Here you can see that the results relate to a                Results      2.1 Increased awareness of the needs of blind people to
particular objective (result 1.1. relating to objective 1,                their entry into the open labor market
the results 2.1 and 2.2 on objective 2)                                   2.2 Increased number of employers who have recognized the
                                                                          potential of blind people

                                                                          1.1.1 Education for blind

                                                                          1.1.1.1 Organizing training if its necessary
   Here you can see mentioned activities and their           Activities   1.1.1.2 Implementation of training
   sub-activities. Each activity is numbered and                          2.1.1 Education about rights and opportunities for
   refer directly to the result. Activity 1.1.1 refers to                 employment of blind persons in the OTR
   the 1.1 result and so on.                                              2.1.1.1 Organizing workshops about the needs
                                                                          2.1.1.2 Implementation of workshops
                                                                          2.2.1 Increase awareness of employers
                                                                          2.2.1.1 Organizing workshops for employers by employment
                                                                          opportunities for blind people

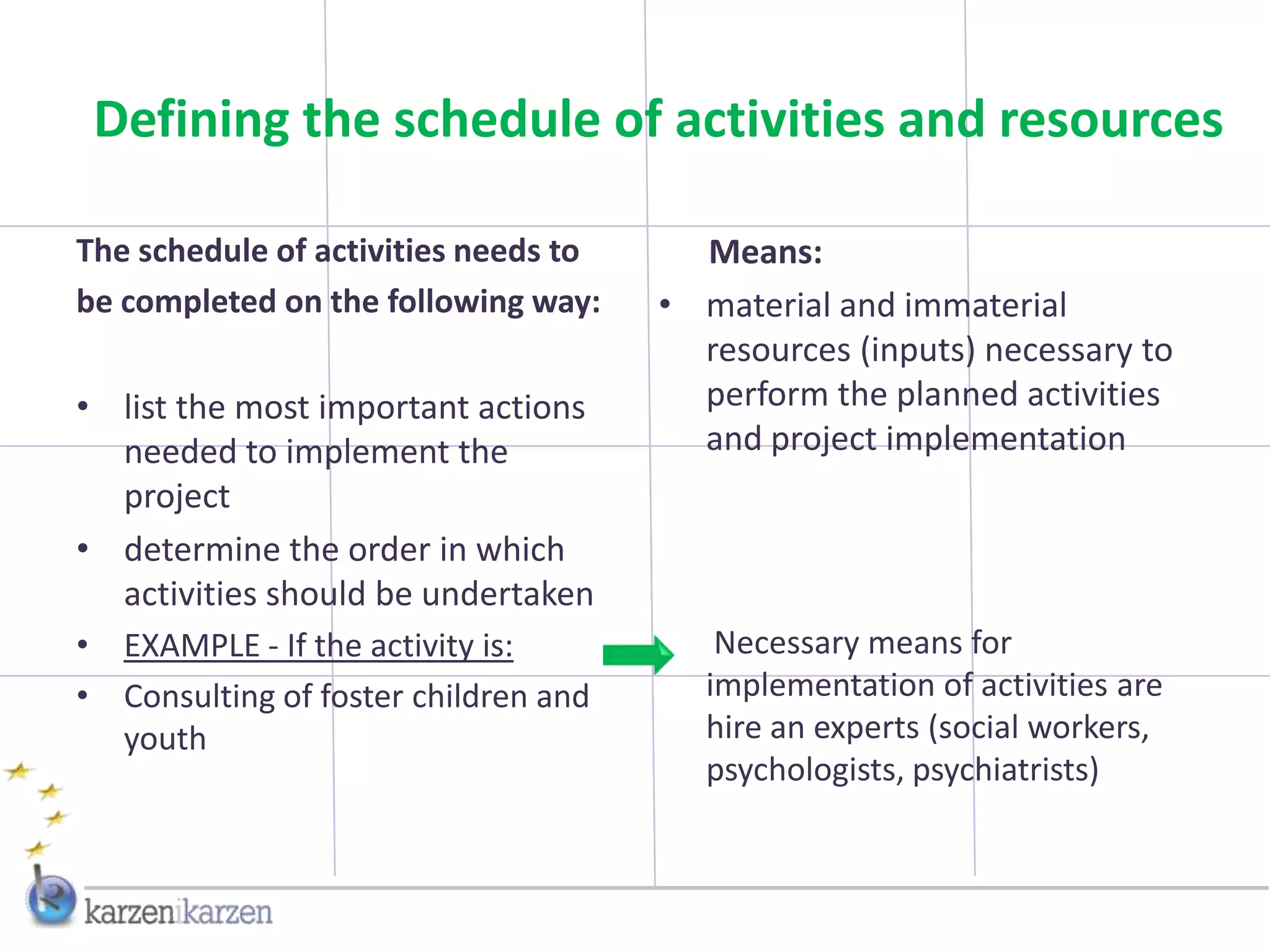

Defining the schedule of activities and resources

The schedule of activities needs to     Means:
be completed on the following way:    • material and immaterial
                                        resources (inputs) necessary to
• list the most important actions       perform the planned activities
  needed to implement the               and project implementation
  project
• determine the order in which
  activities should be undertaken
• EXAMPLE - If the activity is:           Necessary means for
• Consulting of foster children and      implementation of activities are
  youth                                  hire an experts (social workers,
                                         psychologists, psychiatrists)

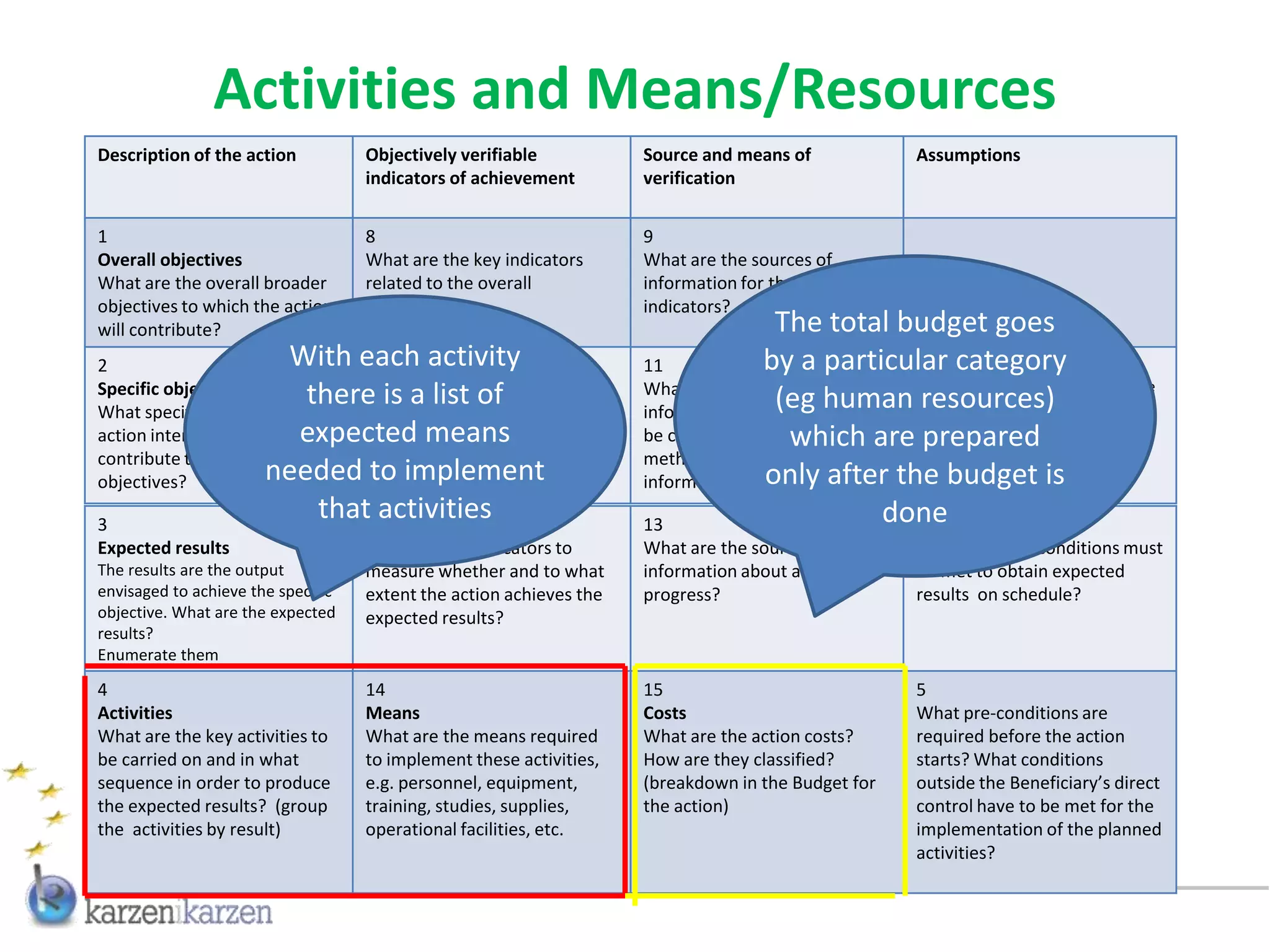

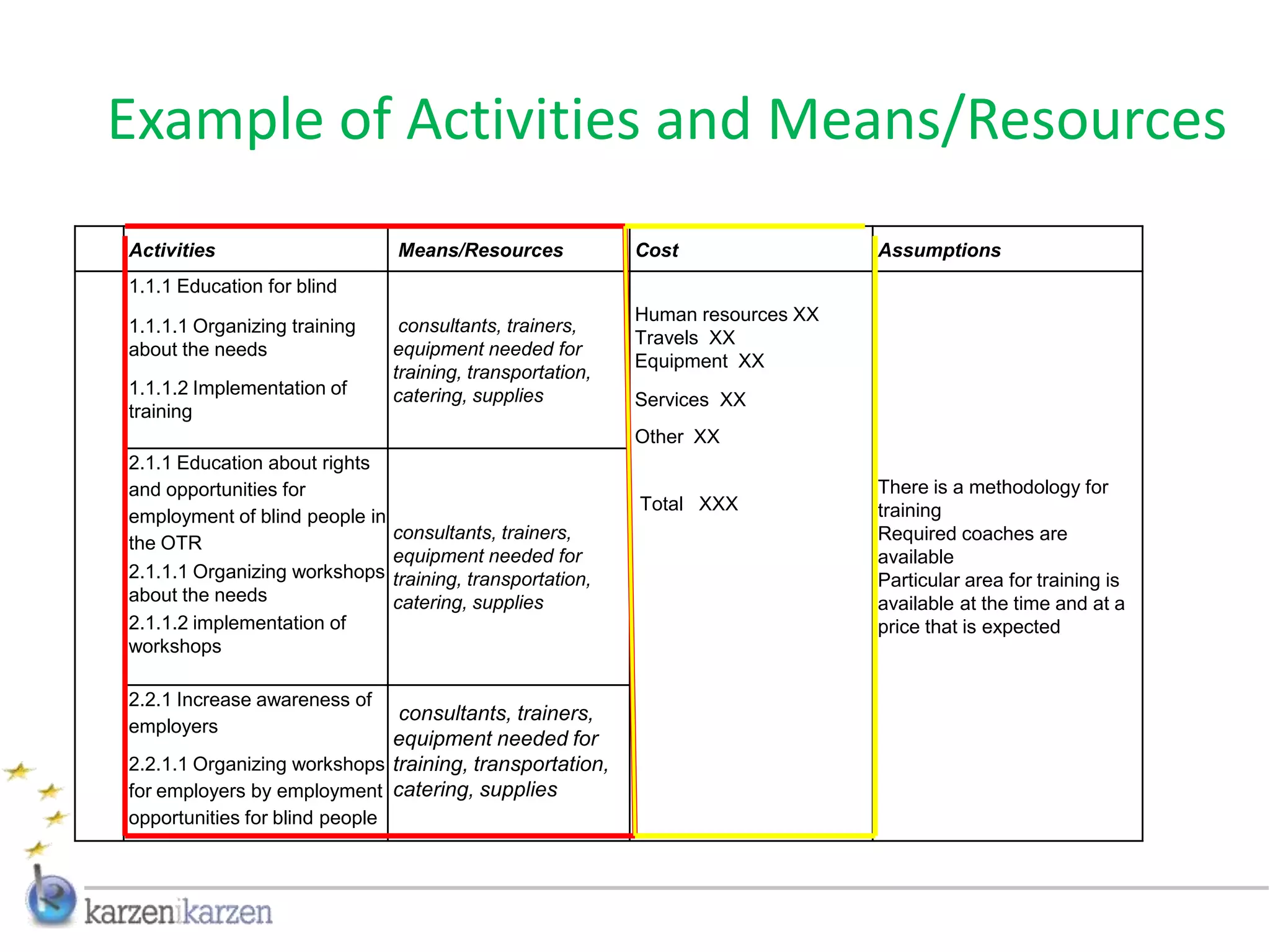

Activities and Means/Resources

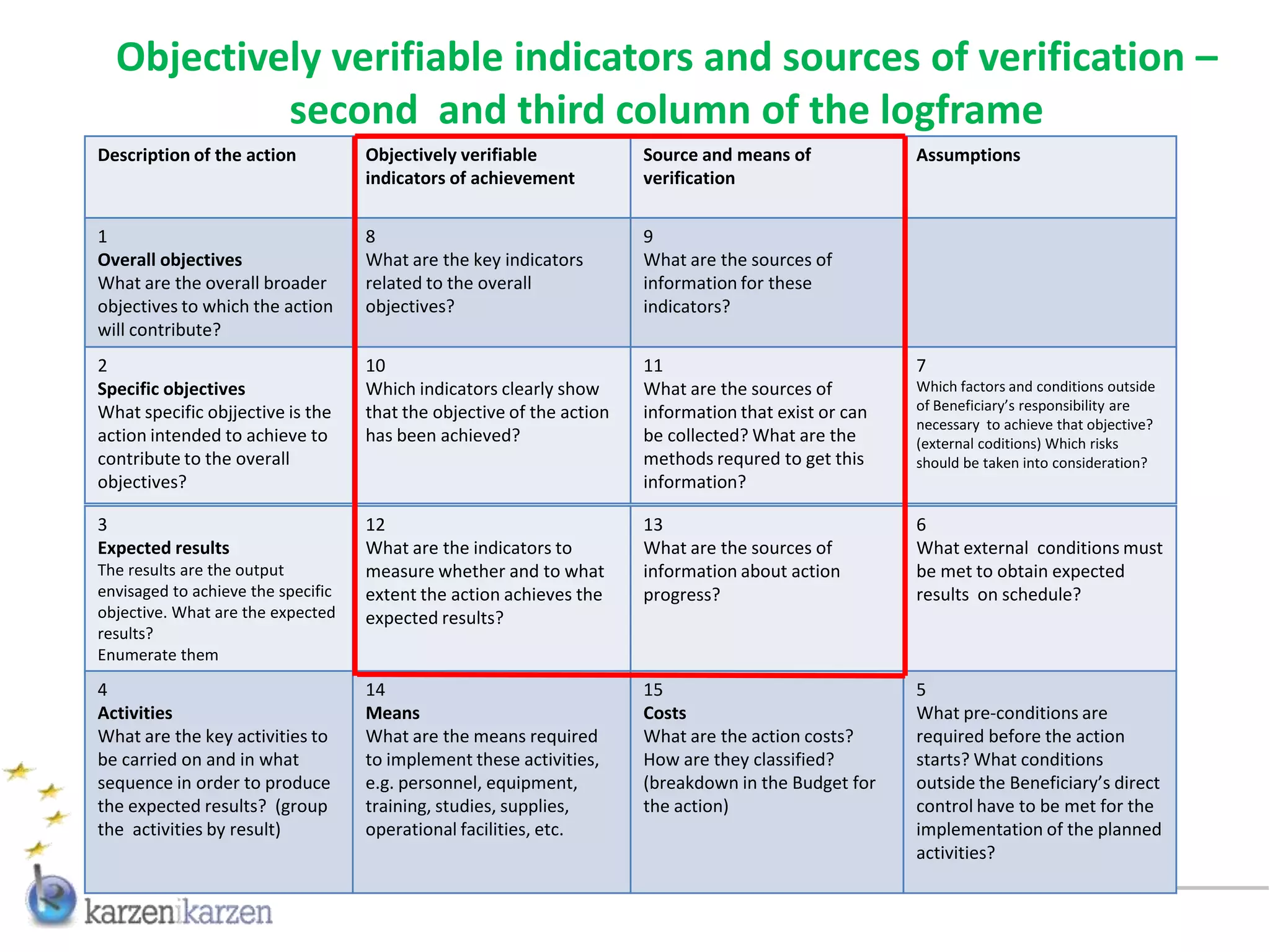

Description of the action           Objectively verifiable           Source and means of                Assumptions
                                    indicators of achievement        verification

1                                   8                                9
Overall objectives                  What are the key indicators      What are the sources of
What are the overall broader        related to the overall           information for these
objectives to which the action      objectives?                      indicators?
will contribute?                                                                     The total budget goes
2                       With each activity
                               10                                    11             by a particular category
                                                                                                    7

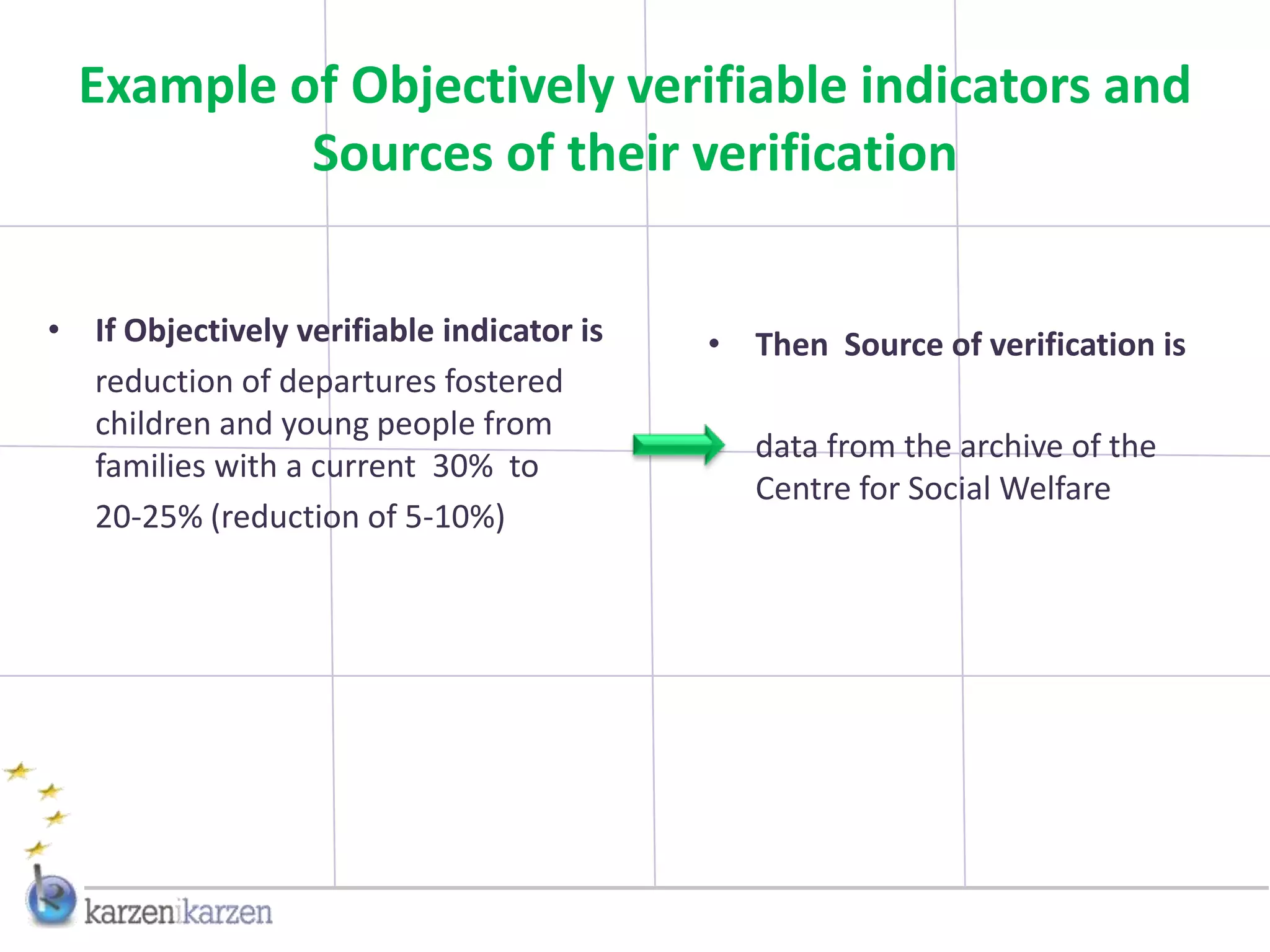

                                                                                                    Which factors and conditions outside
Specific objectives       there isthe list ofclearly show
What specific objjective is thethat
                                    a objective of the action
                               Which indicators                      What are the sources of
                                                                                     (eg or can
                                                                     information that exist
                                                                                            human of Beneficiary’s responsibility are
                                                                                                     resources)
                                                                                                    necessary to achieve that objective?
                         expected means
action intended to achieve to  has been achieved?                    be collected? What are the are (external coditions) Which risks
                                                                                       which         prepared
contribute to the overall                                            methods requred to get this    should be taken into consideration?
objectives?            needed to implement                           information? only after the budget is

3
                           that12activities                          13                          done
                                                                                                    6
Expected results                    What are the indicators to       What are the sources of            What external conditions must
The results are the output          measure whether and to what      information about action           be met to obtain expected
envisaged to achieve the specific   extent the action achieves the   progress?                          results on schedule?
objective. What are the expected    expected results?
results?
Enumerate them

4                                   14                               15                                 5
Activities                          Means                            Costs                              What pre-conditions are
What are the key activities to      What are the means required      What are the action costs?         required before the action
be carried on and in what           to implement these activities,   How are they classified?           starts? What conditions
sequence in order to produce        e.g. personnel, equipment,       (breakdown in the Budget for       outside the Beneficiary’s direct
the expected results? (group        training, studies, supplies,     the action)                        control have to be met for the
the activities by result)           operational facilities, etc.                                        implementation of the planned
                                                                                                        activities?
Example of Activities and Means/Resources
Activities                       Means/Resources             Cost                 Assumptions
1.1.1 Education for blind
                                                             Human resources XX
1.1.1.1 Organizing training       consultants, trainers,
                                                             Travels XX
about the needs                  equipment needed for
                                                             Equipment XX
                                 training, transportation,
1.1.1.2 Implementation of        catering, supplies          Services XX
training
                                                             Other XX
2.1.1 Education about rights
and opportunities for                                                             There is a methodology for
                                                             Total XXX            training
employment of blind people in
                                 consultants, trainers,                           Required coaches are
the OTR
                                 equipment needed for                             available
2.1.1.1 Organizing workshops     training, transportation,                        Particular area for training is
about the needs                  catering, supplies                               available at the time and at a
2.1.1.2 implementation of                                                         price that is expected
workshops

2.2.1 Increase awareness of
                              consultants, trainers,
employers
                             equipment needed for
2.2.1.1 Organizing workshops training, transportation,
for employers by employment catering, supplies
opportunities for blind people

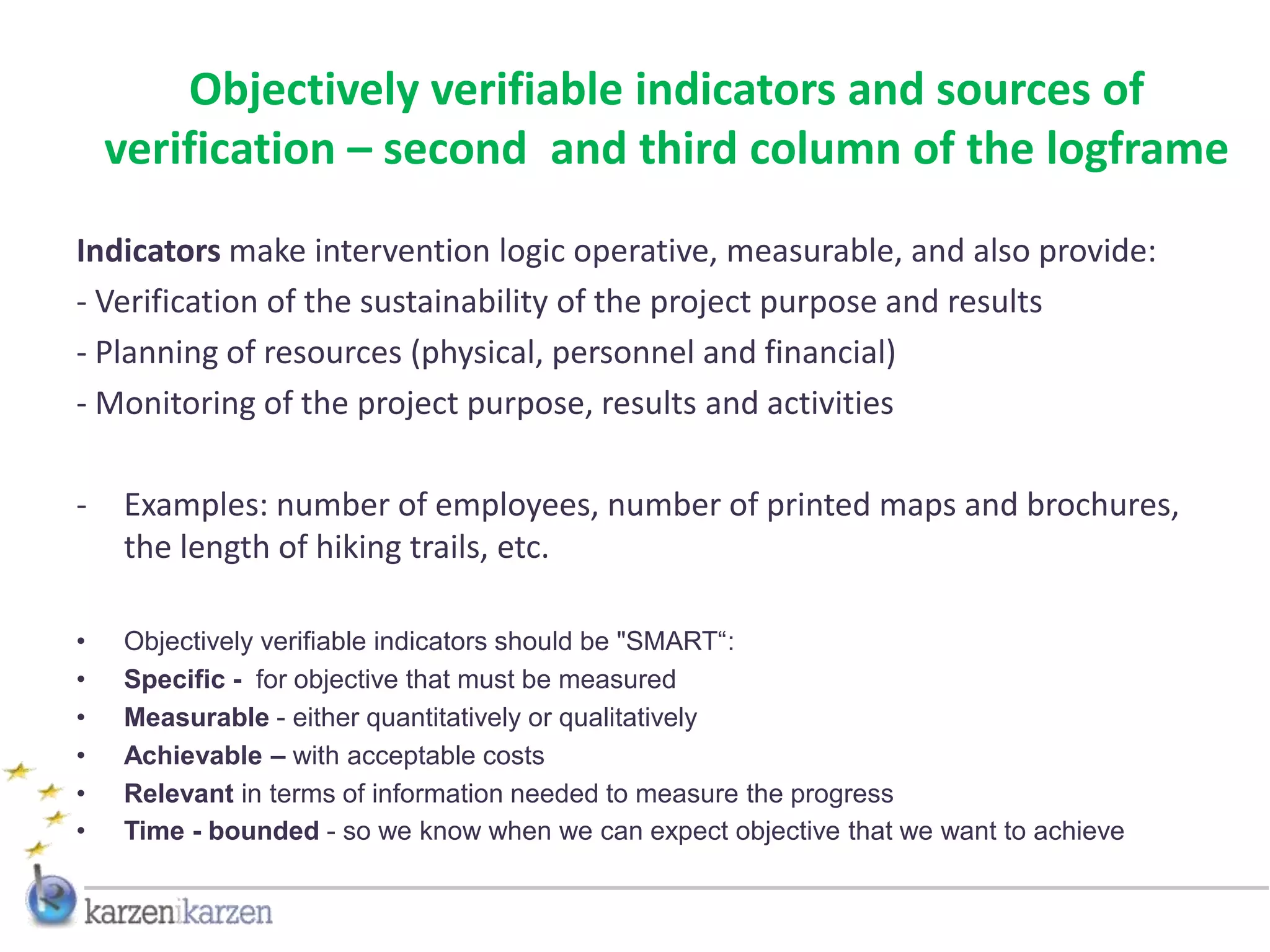

Objectively verifiable indicators and sources of verification –
           second and third column of the logframe
Description of the action           Objectively verifiable             Source and means of             Assumptions
                                    indicators of achievement          verification

1                                   8                                  9
Overall objectives                  What are the key indicators        What are the sources of
What are the overall broader        related to the overall             information for these
objectives to which the action      objectives?                        indicators?
will contribute?
2                                   10                                 11                              7
Specific objectives                 Which indicators clearly show      What are the sources of         Which factors and conditions outside
What specific objjective is the     that the objective of the action   information that exist or can   of Beneficiary’s responsibility are
                                                                                                       necessary to achieve that objective?
action intended to achieve to       has been achieved?                 be collected? What are the      (external coditions) Which risks
contribute to the overall                                              methods requred to get this     should be taken into consideration?
objectives?                                                            information?

3                                   12                                 13                              6
Expected results                    What are the indicators to         What are the sources of         What external conditions must
The results are the output          measure whether and to what        information about action        be met to obtain expected
envisaged to achieve the specific   extent the action achieves the     progress?                       results on schedule?
objective. What are the expected    expected results?
results?
Enumerate them

4                                   14                                 15                              5
Activities                          Means                              Costs                           What pre-conditions are
What are the key activities to      What are the means required        What are the action costs?      required before the action
be carried on and in what           to implement these activities,     How are they classified?        starts? What conditions
sequence in order to produce        e.g. personnel, equipment,         (breakdown in the Budget for    outside the Beneficiary’s direct
the expected results? (group        training, studies, supplies,       the action)                     control have to be met for the
the activities by result)           operational facilities, etc.                                       implementation of the planned
                                                                                                       activities?

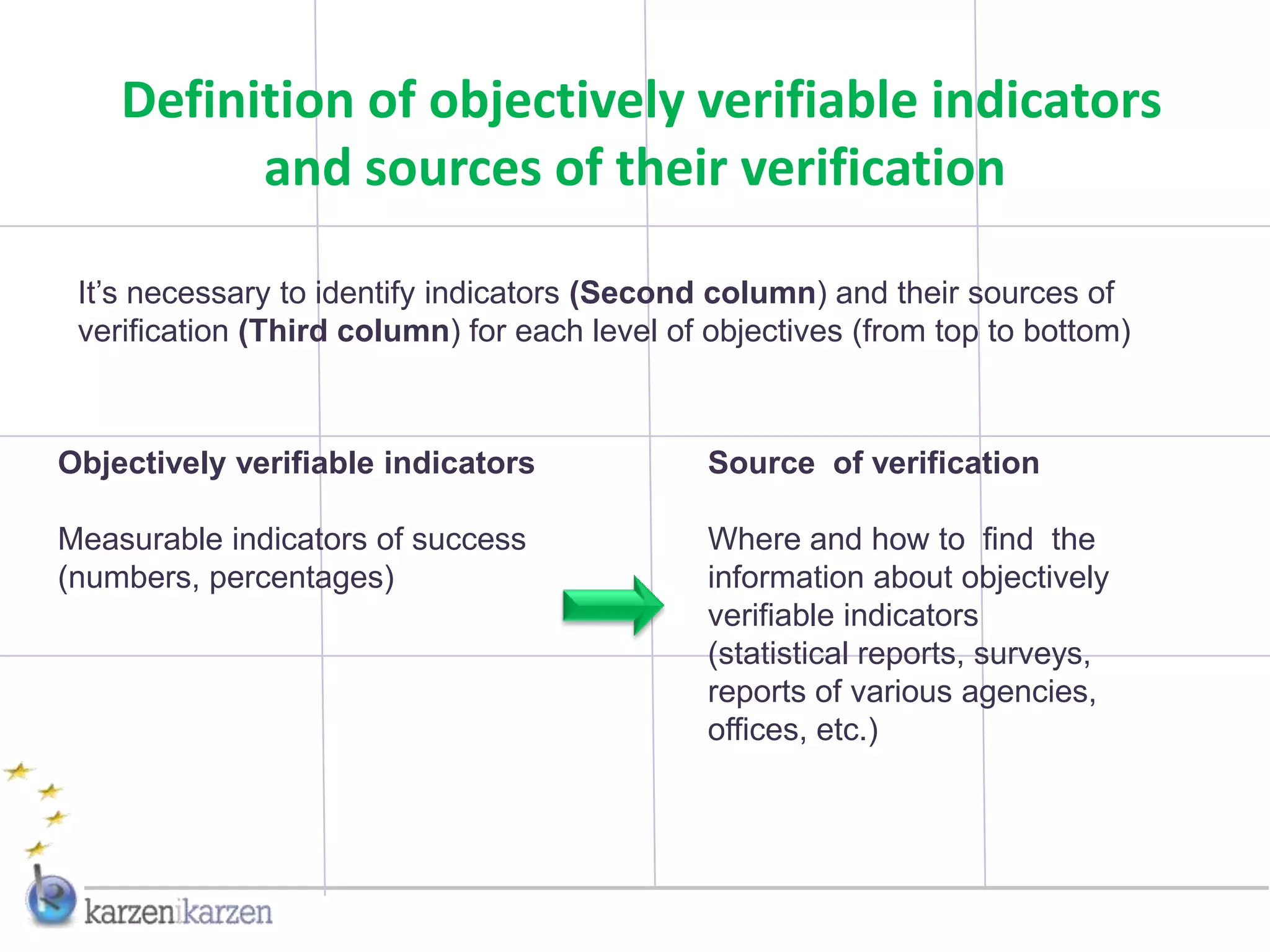

Definition of objectively verifiable indicators
          and sources of their verification

 It’s necessary to identify indicators (Second column) and their sources of
 verification (Third column) for each level of objectives (from top to bottom)

Objectively verifiable indicators              Source of verification

Measurable indicators of success               Where and how to find the
(numbers, percentages)                         information about objectively
                                               verifiable indicators
                                               (statistical reports, surveys,
                                               reports of various agencies,
                                               offices, etc.)
Objectively verifiable indicators and sources of
    verification – second and third column of the logframe
Indicators make intervention logic operative, measurable, and also provide:
- Verification of the sustainability of the project purpose and results
- Planning of resources (physical, personnel and financial)
- Monitoring of the project purpose, results and activities

-   Examples: number of employees, number of printed maps and brochures,
    the length of hiking trails, etc.

•   Objectively verifiable indicators should be "SMART“:
•   Specific - for objective that must be measured
•   Measurable - either quantitatively or qualitatively
•   Achievable – with acceptable costs
•   Relevant in terms of information needed to measure the progress
•   Time - bounded - so we know when we can expect objective that we want to achieve

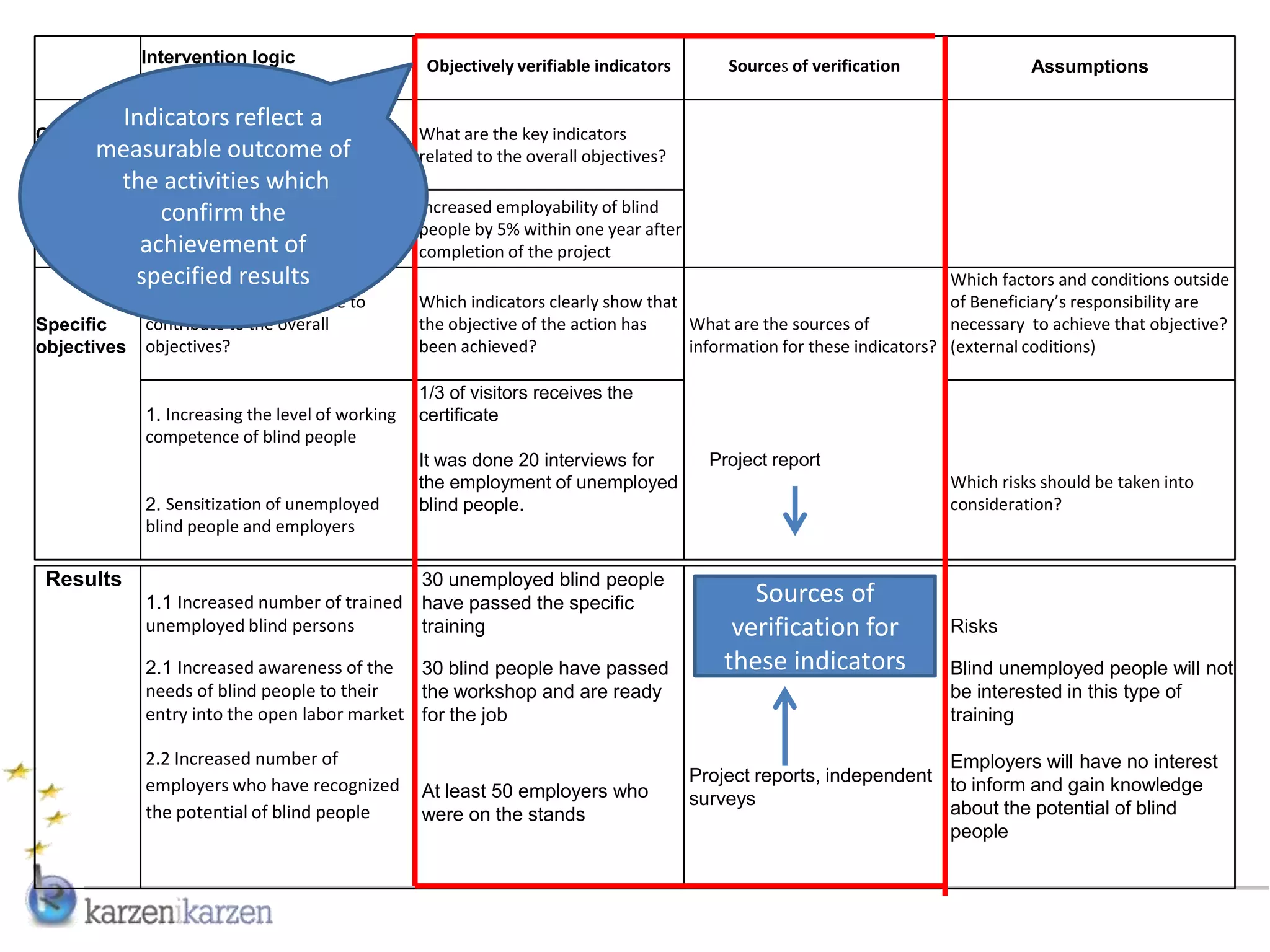

Intervention logic                     Objectively verifiable indicators       Sources of verification               Assumptions

          Indicators reflectbroader
            What are the overall a
Overall     objectives to which the action will What are the key indicators
       measurable outcome of
objective   contribute?                         related to the overall objectives?
           the activities which
             Increasing the employability of       Increased employability of blind
               confirm the
             blind people on the open labor        people by 5% within one year after
             achievement of
             market                                completion of the project
            specified results is the
             What specific objjective                                                                                   Which factors and conditions outside
              action intended to achieve to        Which indicators clearly show that                                   of Beneficiary’s responsibility are
Specific      contribute to the overall            the objective of the action has    What are the sources of           necessary to achieve that objective?
objectives    objectives?                          been achieved?                     information for these indicators? (external coditions)

                                                   1/3 of visitors receives the
              1. Increasing the level of working   certificate
              competence of blind people
                                                   It was done 20 interviews for          Project report
                                                   the employment of unemployed                                        Which risks should be taken into
              2. Sensitization of unemployed       blind people.                                                       consideration?
              blind people and employers

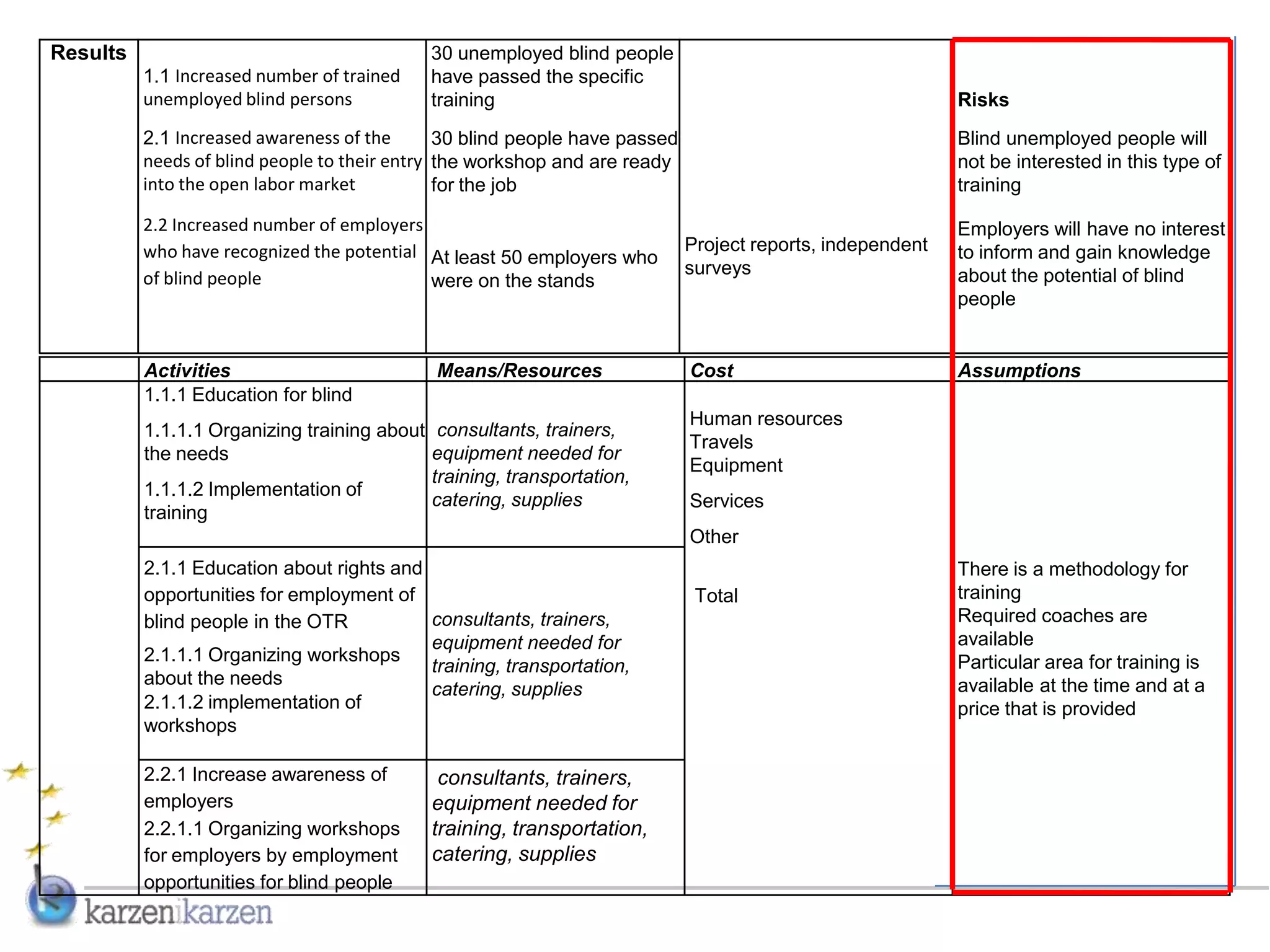

 Results                                      30 unemployed blind people
              1.1 Increased number of trained have passed the specific                        Sources of
              unemployed blind persons        training                                      verification for           Risks

              2.1 Increased awareness of the 30 blind people have passed                   these indicators            Blind unemployed people will not
              needs of blind people to their   the workshop and are ready                                              be interested in this type of
              entry into the open labor market for the job                                                             training

              2.2 Increased number of                                                                                Employers will have no interest
              employers who have recognized                                             Project reports, independent to inform and gain knowledge
                                                   At least 50 employers who            surveys
              the potential of blind people        were on the stands                                                about the potential of blind
                                                                                                                     people

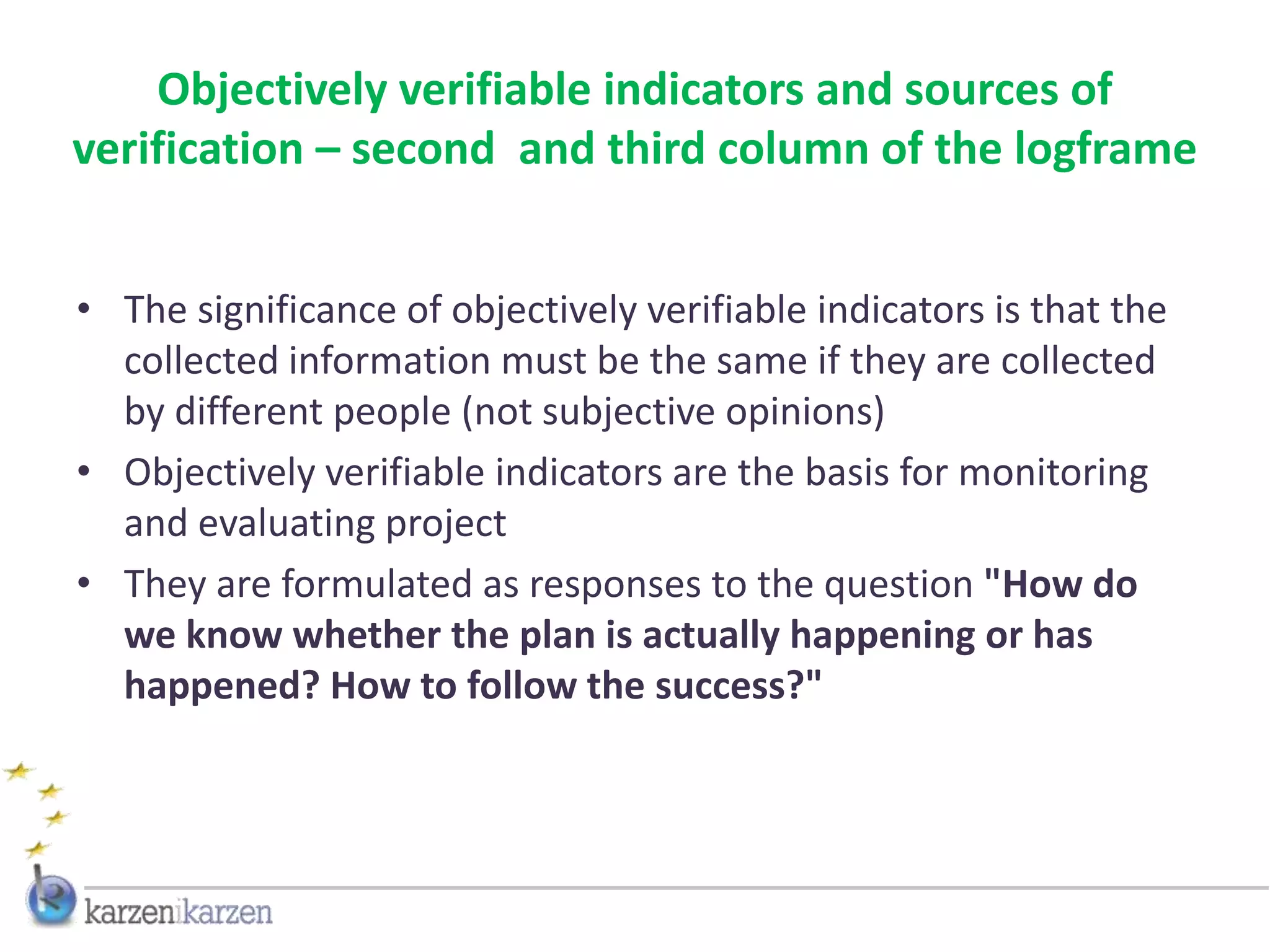

Objectively verifiable indicators and sources of
verification – second and third column of the logframe

• The significance of objectively verifiable indicators is that the
  collected information must be the same if they are collected
  by different people (not subjective opinions)
• Objectively verifiable indicators are the basis for monitoring
  and evaluating project
• They are formulated as responses to the question "How do
  we know whether the plan is actually happening or has
  happened? How to follow the success?"

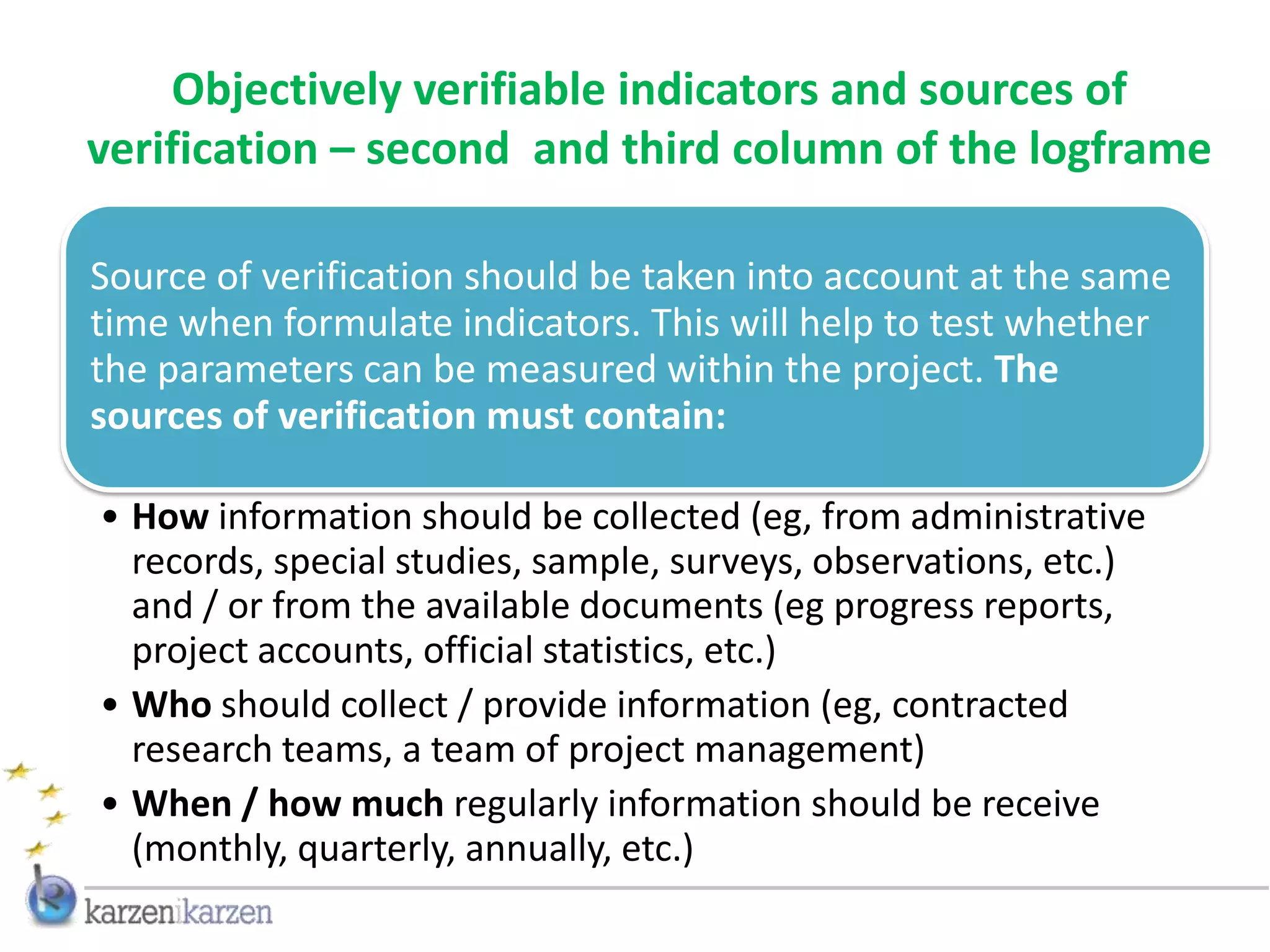

Objectively verifiable indicators and sources of
verification – second and third column of the logframe

Source of verification should be taken into account at the same
time when formulate indicators. This will help to test whether
the parameters can be measured within the project. The
sources of verification must contain:

• How information should be collected (eg, from administrative
  records, special studies, sample, surveys, observations, etc.)
  and / or from the available documents (eg progress reports,
  project accounts, official statistics, etc.)
• Who should collect / provide information (eg, contracted
  research teams, a team of project management)
• When / how much regularly information should be receive
  (monthly, quarterly, annually, etc.)
Example of Objectively verifiable indicators and
           Sources of their verification

• If Objectively verifiable indicator is   • Then Source of verification is
  reduction of departures fostered
  children and young people from
                                              data from the archive of the
  families with a current 30% to
                                              Centre for Social Welfare
  20-25% (reduction of 5-10%)

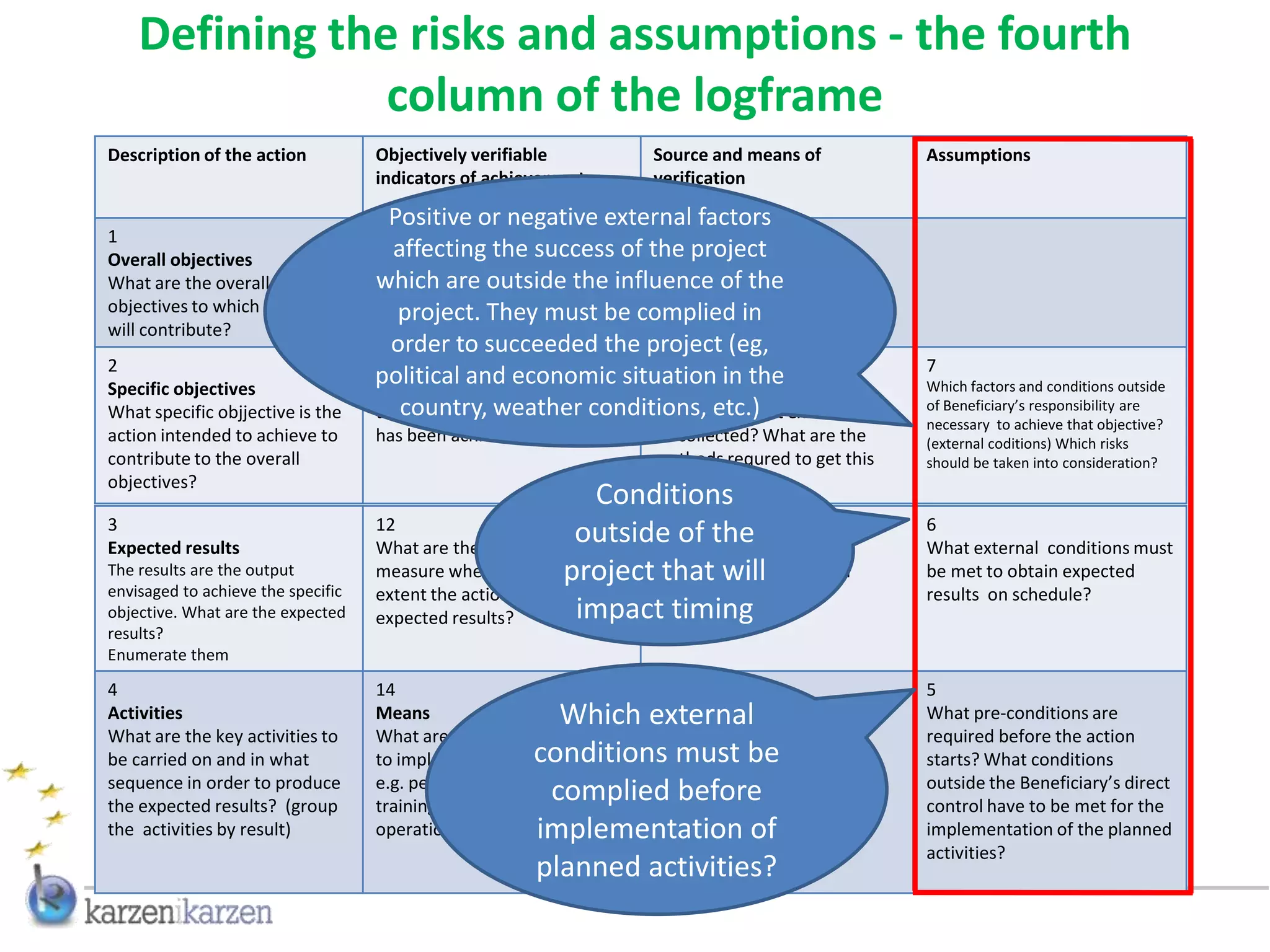

Defining the risks and assumptions - the fourth
            column of the logframe
FOURTH COLUMN - defined assumptions (from bottom to top
for each level of objectives)
- Assumptions        what could disrupt the implementation of the
project or affect its performance, and the fact that we can’t influence on that?
-To fill a column of assumptions is necessary:
-define the risks that are contained in each activity
-converting the identified risks in the assumptions

- Precondition is the assumption that must be filled in order
  to started on the activities

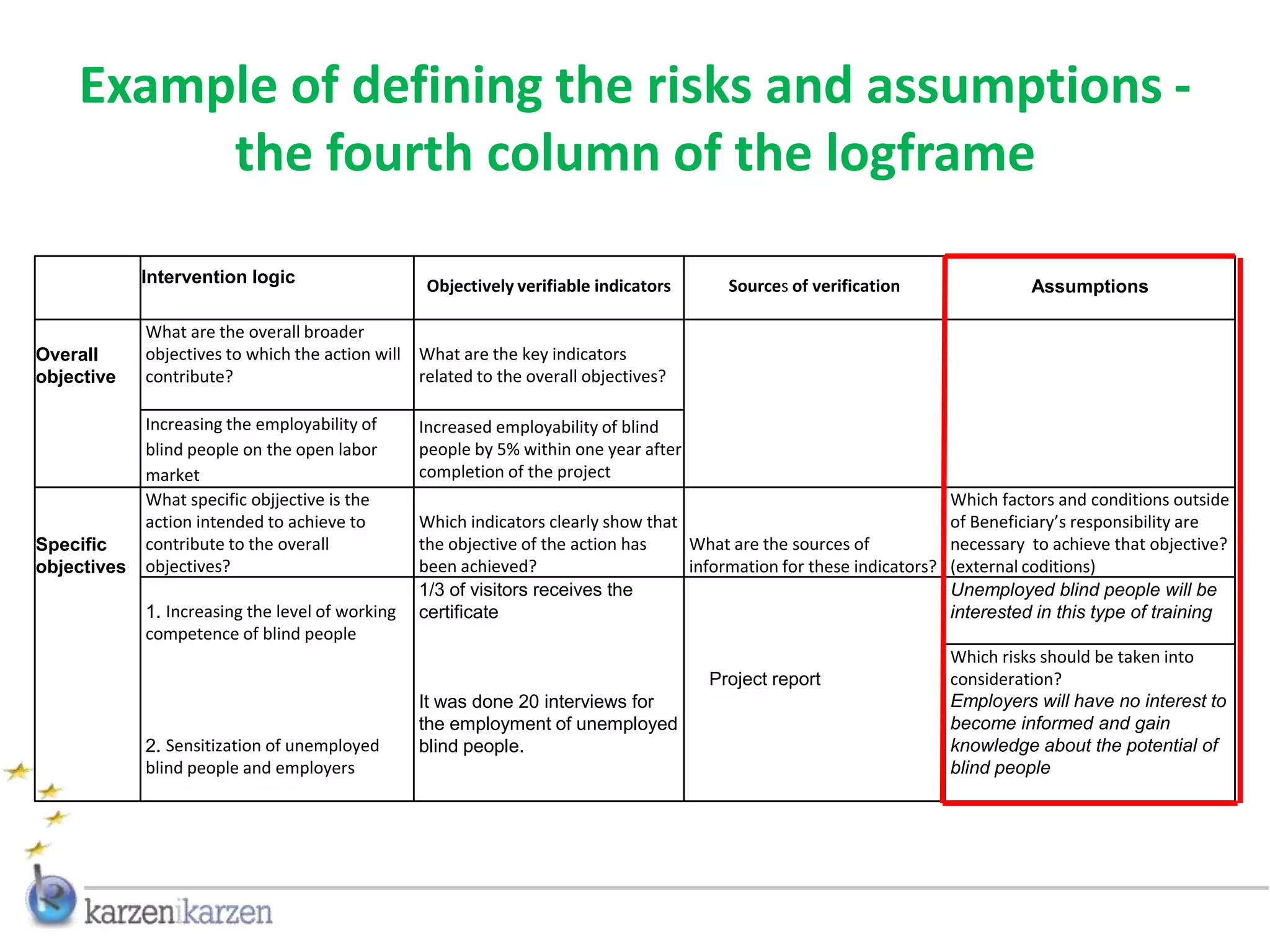

Defining the risks and assumptions - the fourth
                column of the logframe
Description of the action           Objectively verifiable           Source and means of            Assumptions
                                    indicators of achievement        verification

                                     Positive or negative external factors
1                                   8                               9
Overall objectives                  What are the key indicators of the project
                                      affecting the success What are the sources of
What are the overall broader        related to the outside the influence of the
                                    which are overall               information for these
objectives to which the action      objectives? They must be complied in
                                       project.                     indicators?
will contribute?
                                     order to succeeded the project (eg,
2                                   10
Specific objectives                 Which indicators
                                                      economic 11 are the sources of
                                    political and clearly show situation in the
                                                                     What
                                                                                                    7
                                                                                                    Which factors and conditions outside
What specific objjective is the        country, weather conditions, etc.) exist or can
                                    that the objective of the action information that               of Beneficiary’s responsibility are
                                                                                                    necessary to achieve that objective?
action intended to achieve to       has been achieved?               be collected? What are the     (external coditions) Which risks
contribute to the overall                                            methods requred to get this    should be taken into consideration?
objectives?                                                          information?
                                                                Conditions
3                                   12                             13                               6
Expected results
                                                             outside ofare the sources of
                                    What are the indicators to     What
                                                                          the                       What external conditions must
The results are the output                                  projectinformation about action
                                    measure whether and to what     that will                       be met to obtain expected
envisaged to achieve the specific   extent the action achieves the progress?                        results on schedule?
objective. What are the expected    expected results?        impact timing
results?
Enumerate them

4                                   14                               15                             5
Activities                          Means                 Which external
                                                                     Costs                          What pre-conditions are
What are the key activities to      What are the means required      What are the action costs?     required before the action
be carried on and in what                               conditions must be
                                    to implement these activities,   How are they classified?       starts? What conditions
sequence in order to produce        e.g. personnel, equipment,       (breakdown in the Budget for   outside the Beneficiary’s direct
the expected results? (group
                                                         complied before
                                    training, studies, supplies,     the action)                    control have to be met for the
the activities by result)                               implementation of
                                    operational facilities, etc.                                    implementation of the planned
                                                                                                    activities?
                                                        planned activities?
Example of defining the risks and assumptions -
         the fourth column of the logframe
             Intervention logic                    Objectively verifiable indicators      Sources of verification                  Assumptions

             What are the overall broader
Overall      objectives to which the action will What are the key indicators
objective    contribute?                         related to the overall objectives?

             Increasing the employability of      Increased employability of blind
             blind people on the open labor       people by 5% within one year after
             market                               completion of the project
             What specific objjective is the                                                                             Which factors and conditions outside
             action intended to achieve to        Which indicators clearly show that                                     of Beneficiary’s responsibility are
Specific     contribute to the overall            the objective of the action has    What are the sources of             necessary to achieve that objective?
objectives   objectives?                          been achieved?                     information for these indicators?   (external coditions)
                                                  1/3 of visitors receives the                                           Unemployed blind people will be
             1. Increasing the level of working   certificate                                                            interested in this type of training
             competence of blind people
                                                                                                                         Which risks should be taken into
                                                                                        Project report                   consideration?
                                                  It was done 20 interviews for                                          Employers will have no interest to
                                                  the employment of unemployed                                           become informed and gain
             2. Sensitization of unemployed       blind people.                                                          knowledge about the potential of
             blind people and employers                                                                                  blind people
Results                                     30 unemployed blind people
          1.1 Increased number of trained   have passed the specific
          unemployed blind persons          training                                                        Risks
          2.1 Increased awareness of the       30 blind people have passed                                  Blind unemployed people will
          needs of blind people to their entry the workshop and are ready                                   not be interested in this type of
          into the open labor market           for the job                                                  training

          2.2 Increased number of employers                                                                 Employers will have no interest
          who have recognized the potential At least 50 employers who        Project reports, independent   to inform and gain knowledge
                                                                             surveys                        about the potential of blind
          of blind people                   were on the stands
                                                                                                            people

          Activities                         Means/Resources                 Cost                           Assumptions
          1.1.1 Education for blind
                                                                             Human resources
          1.1.1.1 Organizing training about consultants, trainers,
                                                                             Travels
          the needs                         equipment needed for
                                                                             Equipment
                                            training, transportation,
          1.1.1.2 Implementation of
                                            catering, supplies               Services
          training
                                                                             Other
          2.1.1 Education about rights and                                                                  There is a methodology for
          opportunities for employment of                                     Total                         training
          blind people in the OTR          consultants, trainers,                                           Required coaches are
                                           equipment needed for                                             available
          2.1.1.1 Organizing workshops                                                                      Particular area for training is
                                           training, transportation,
          about the needs                                                                                   available at the time and at a
                                           catering, supplies
          2.1.1.2 implementation of                                                                         price that is provided
          workshops

          2.2.1 Increase awareness of        consultants, trainers,
          employers                         equipment needed for
          2.2.1.1 Organizing workshops      training, transportation,
          for employers by employment       catering, supplies
          opportunities for blind people

Preparing a logical framework for your project

  • 1.
    Project planning usingthe logical framework approach In the preparation of project proposal the logical framework approach is used as part of more comprehensive method of Project Cycle Management (PCM) which facilitates project development
  • 2.
    What have youachieved? The default problem has been identified Context of the problem is understandable Project idea that help solving a problem is identified and discussed among all stakeholders The project has clear and realistic goals Target groups of the project are identified and consulted
  • 3.
    Logical Framework Matrix- meaning • Logical framework approach has two phases: • The analysis phase • phase of planning and project management • Logical framework Product of that process! A table that contains: – hierarchy of project objectives – key external factors that affect the project – ways that will be monitored and evaluate project implementation – basis for determining the necessary resources and budget
  • 4.
    Order of logicalframework creation
  • 5.
    Logical framework matrix Numbersin boxes indicate the order of filling in the logframe, arrows indicate reverse logical following Description of the action Objectively verifiable Source and means of Assumptions indicators of achievement verification 1 8 9 Overall objectives What are the key indicators What are the sources of What are the overall broader related to the overall information for these objectives to which the action objectives? indicators? will contribute? 2 10 11 7 Specific objectives Which indicators clearly show What are the sources of Which factors and conditions outside What specific objjective is the that the objective of the action information that exist or can of Beneficiary’s responsibility are necessary to achieve that objective? action intended to achieve to has been achieved? be collected? What are the (external coditions) Which risks contribute to the overall methods requred to get this should be taken into consideration? objectives? information? 3 12 13 6 Expected results What are the indicators to What are the sources of What external conditions must The results are the output measure whether and to what information about action be met to obtain expected envisaged to achieve the specific extent the action achieves the progress? results on schedule? objective. What are the expected expected results? results? Enumerate them 4 14 15 5 Activities Means Costs What pre-conditions are What are the key activities to What are the means required What are the action costs? required before the action be carried on and in what to implement these activities, How are they classified? starts? What conditions sequence in order to produce e.g. personnel, equipment, (breakdown in the Budget for outside the Beneficiary’s direct the expected results? (group training, studies, supplies, the action) control have to be met for the the activities by result) operational facilities, etc. implementation of the planned activities?
  • 6.
    Intervention logic • Thelogical Framework must demonstrate reverse logic as follows:  If the funds are provided, it is possible to pay for the needed resources  If the needed resources are available, it’s possible to implement the activities  If activities are carried out, the planned indicators for results can be achieved  If the result indicators are achieved, the planned results can be achieved  If the results are achieved, the specific objective indicators can be achieved  If the SO indicators are achieved, The SO can be achieved  If the SO is achieved, the project will achieve the overall object indicators  If the OO indicators are achieved, the OO can be contributed towards Look at the previous slide!
  • 7.
    Step 1: The formulation of a logical intervention First column - from overall objectives to the activities (from top to the bottom) Overall objective Specific Specific objective objective Result Result Result Result Activities Activities Activities Activities Activities Activities Activities Activities Look at the notes!
  • 8.
    Completing the firstcolumn Description of the action Objectively verifiable Source and means of Assumptions indicators of achievement verification 1 8 9 Overall objectives What are the key indicators What are the sources of What are the overall broader related to the overall information for these objectives to which the action objectives? indicators? will contribute? 2 10 11 7 Specific objectives Which indicators clearly show What are the sources of Which factors and conditions outside What specific objjective is the that the objective of the action information that exist or can of Beneficiary’s responsibility are necessary to achieve that objective? action intended to achieve to has been achieved? be collected? What are the (external coditions) Which risks contribute to the overall methods requred to get this should be taken into consideration? objectives? information? 3 12 13 6 Expected results What are the indicators to What are the sources of What external conditions must The results are the output measure whether and to what information about action be met to obtain expected envisaged to achieve the specific extent the action achieves the progress? results on schedule? objective. What are the expected expected results? results? Enumerate them 4 14 15 5 Activities Means Costs What pre-conditions are What are the key activities to What are the means required What are the action costs? required before the action be carried on and in what to implement these activities, How are they classified? starts? What conditions sequence in order to produce e.g. personnel, equipment, (breakdown in the Budget for outside the Beneficiary’s direct the expected results? (group training, studies, supplies, the action) control have to be met for the the activities by result) operational facilities, etc. implementation of the planned activities?
  • 9.
    Completing the firstcolumn The overall objective - shows the long-term Intervention importance of the project for the target group and logic the contribution of a priority program. A well- What are the overall broader defined overall objective should be in accordance objectives to which the action will contribute? with the broader goals (watch out at the consistency of the logical framework and an application form). Specific objectives - must be connected with the What specific objective is the overall objective and demonstrate the improved action intended to achieve to situation of target groups which are reached contribute to the overall objectives? through the project until its completion. Results - main products of the project that lead The results are the outputs envisaged to to specific objectives and are based on the achieve the specific objective. requirements of target groups and regions. We What are the expected results? (enumerate them) should not plan more than two results per specific objective. What are the key activities to be carried out Activities - serve to achieve the project results. One or group of activity must lead to one of the and in what sequence in order to produce identified results. In this phase should include the expected results? (group the activities by result) only the most important activities.
  • 10.
    An example ofthe completed overall objective, specific objectives, results and activities - first column of the logframe! Overall objectives are very broad in its scope. 99% of Intervention logic the time that this objective should refer to the "global" Overall Increasing the employability of blind people on the open objective, something that most of the time reflects the objectives labor market overall objective of the program. Specific objectives are "the real objectives of the 1. Increasing the level of working competence of blind project", which means that they reflect what the Specific people applicant is trying to achieve on the more specific way objectives than overall objective. It should be used between 2 and 3 objectives. If you have more, combine them into 2. Sensitization of unemployed blind people and employers related objectives that are broad in its scope. 1.1 Increased number of trained unemployed blind persons Here you can see that the results relate to a Results 2.1 Increased awareness of the needs of blind people to particular objective (result 1.1. relating to objective 1, their entry into the open labor market the results 2.1 and 2.2 on objective 2) 2.2 Increased number of employers who have recognized the potential of blind people 1.1.1 Education for blind 1.1.1.1 Organizing training if its necessary Here you can see mentioned activities and their Activities 1.1.1.2 Implementation of training sub-activities. Each activity is numbered and 2.1.1 Education about rights and opportunities for refer directly to the result. Activity 1.1.1 refers to employment of blind persons in the OTR the 1.1 result and so on. 2.1.1.1 Organizing workshops about the needs 2.1.1.2 Implementation of workshops 2.2.1 Increase awareness of employers 2.2.1.1 Organizing workshops for employers by employment opportunities for blind people
  • 11.
    Defining the scheduleof activities and resources The schedule of activities needs to Means: be completed on the following way: • material and immaterial resources (inputs) necessary to • list the most important actions perform the planned activities needed to implement the and project implementation project • determine the order in which activities should be undertaken • EXAMPLE - If the activity is: Necessary means for • Consulting of foster children and implementation of activities are youth hire an experts (social workers, psychologists, psychiatrists)
  • 12.
    Activities and Means/Resources Descriptionof the action Objectively verifiable Source and means of Assumptions indicators of achievement verification 1 8 9 Overall objectives What are the key indicators What are the sources of What are the overall broader related to the overall information for these objectives to which the action objectives? indicators? will contribute? The total budget goes 2 With each activity 10 11 by a particular category 7 Which factors and conditions outside Specific objectives there isthe list ofclearly show What specific objjective is thethat a objective of the action Which indicators What are the sources of (eg or can information that exist human of Beneficiary’s responsibility are resources) necessary to achieve that objective? expected means action intended to achieve to has been achieved? be collected? What are the are (external coditions) Which risks which prepared contribute to the overall methods requred to get this should be taken into consideration? objectives? needed to implement information? only after the budget is 3 that12activities 13 done 6 Expected results What are the indicators to What are the sources of What external conditions must The results are the output measure whether and to what information about action be met to obtain expected envisaged to achieve the specific extent the action achieves the progress? results on schedule? objective. What are the expected expected results? results? Enumerate them 4 14 15 5 Activities Means Costs What pre-conditions are What are the key activities to What are the means required What are the action costs? required before the action be carried on and in what to implement these activities, How are they classified? starts? What conditions sequence in order to produce e.g. personnel, equipment, (breakdown in the Budget for outside the Beneficiary’s direct the expected results? (group training, studies, supplies, the action) control have to be met for the the activities by result) operational facilities, etc. implementation of the planned activities?
  • 13.
    Example of Activitiesand Means/Resources Activities Means/Resources Cost Assumptions 1.1.1 Education for blind Human resources XX 1.1.1.1 Organizing training consultants, trainers, Travels XX about the needs equipment needed for Equipment XX training, transportation, 1.1.1.2 Implementation of catering, supplies Services XX training Other XX 2.1.1 Education about rights and opportunities for There is a methodology for Total XXX training employment of blind people in consultants, trainers, Required coaches are the OTR equipment needed for available 2.1.1.1 Organizing workshops training, transportation, Particular area for training is about the needs catering, supplies available at the time and at a 2.1.1.2 implementation of price that is expected workshops 2.2.1 Increase awareness of consultants, trainers, employers equipment needed for 2.2.1.1 Organizing workshops training, transportation, for employers by employment catering, supplies opportunities for blind people
  • 14.
    Objectively verifiable indicatorsand sources of verification – second and third column of the logframe Description of the action Objectively verifiable Source and means of Assumptions indicators of achievement verification 1 8 9 Overall objectives What are the key indicators What are the sources of What are the overall broader related to the overall information for these objectives to which the action objectives? indicators? will contribute? 2 10 11 7 Specific objectives Which indicators clearly show What are the sources of Which factors and conditions outside What specific objjective is the that the objective of the action information that exist or can of Beneficiary’s responsibility are necessary to achieve that objective? action intended to achieve to has been achieved? be collected? What are the (external coditions) Which risks contribute to the overall methods requred to get this should be taken into consideration? objectives? information? 3 12 13 6 Expected results What are the indicators to What are the sources of What external conditions must The results are the output measure whether and to what information about action be met to obtain expected envisaged to achieve the specific extent the action achieves the progress? results on schedule? objective. What are the expected expected results? results? Enumerate them 4 14 15 5 Activities Means Costs What pre-conditions are What are the key activities to What are the means required What are the action costs? required before the action be carried on and in what to implement these activities, How are they classified? starts? What conditions sequence in order to produce e.g. personnel, equipment, (breakdown in the Budget for outside the Beneficiary’s direct the expected results? (group training, studies, supplies, the action) control have to be met for the the activities by result) operational facilities, etc. implementation of the planned activities?
  • 15.
    Definition of objectivelyverifiable indicators and sources of their verification It’s necessary to identify indicators (Second column) and their sources of verification (Third column) for each level of objectives (from top to bottom) Objectively verifiable indicators Source of verification Measurable indicators of success Where and how to find the (numbers, percentages) information about objectively verifiable indicators (statistical reports, surveys, reports of various agencies, offices, etc.)
  • 16.
    Objectively verifiable indicatorsand sources of verification – second and third column of the logframe Indicators make intervention logic operative, measurable, and also provide: - Verification of the sustainability of the project purpose and results - Planning of resources (physical, personnel and financial) - Monitoring of the project purpose, results and activities - Examples: number of employees, number of printed maps and brochures, the length of hiking trails, etc. • Objectively verifiable indicators should be "SMART“: • Specific - for objective that must be measured • Measurable - either quantitatively or qualitatively • Achievable – with acceptable costs • Relevant in terms of information needed to measure the progress • Time - bounded - so we know when we can expect objective that we want to achieve
  • 17.
    Intervention logic Objectively verifiable indicators Sources of verification Assumptions Indicators reflectbroader What are the overall a Overall objectives to which the action will What are the key indicators measurable outcome of objective contribute? related to the overall objectives? the activities which Increasing the employability of Increased employability of blind confirm the blind people on the open labor people by 5% within one year after achievement of market completion of the project specified results is the What specific objjective Which factors and conditions outside action intended to achieve to Which indicators clearly show that of Beneficiary’s responsibility are Specific contribute to the overall the objective of the action has What are the sources of necessary to achieve that objective? objectives objectives? been achieved? information for these indicators? (external coditions) 1/3 of visitors receives the 1. Increasing the level of working certificate competence of blind people It was done 20 interviews for Project report the employment of unemployed Which risks should be taken into 2. Sensitization of unemployed blind people. consideration? blind people and employers Results 30 unemployed blind people 1.1 Increased number of trained have passed the specific Sources of unemployed blind persons training verification for Risks 2.1 Increased awareness of the 30 blind people have passed these indicators Blind unemployed people will not needs of blind people to their the workshop and are ready be interested in this type of entry into the open labor market for the job training 2.2 Increased number of Employers will have no interest employers who have recognized Project reports, independent to inform and gain knowledge At least 50 employers who surveys the potential of blind people were on the stands about the potential of blind people
  • 18.
    Objectively verifiable indicatorsand sources of verification – second and third column of the logframe • The significance of objectively verifiable indicators is that the collected information must be the same if they are collected by different people (not subjective opinions) • Objectively verifiable indicators are the basis for monitoring and evaluating project • They are formulated as responses to the question "How do we know whether the plan is actually happening or has happened? How to follow the success?"
  • 19.
    Objectively verifiable indicatorsand sources of verification – second and third column of the logframe Source of verification should be taken into account at the same time when formulate indicators. This will help to test whether the parameters can be measured within the project. The sources of verification must contain: • How information should be collected (eg, from administrative records, special studies, sample, surveys, observations, etc.) and / or from the available documents (eg progress reports, project accounts, official statistics, etc.) • Who should collect / provide information (eg, contracted research teams, a team of project management) • When / how much regularly information should be receive (monthly, quarterly, annually, etc.)
  • 20.
    Example of Objectivelyverifiable indicators and Sources of their verification • If Objectively verifiable indicator is • Then Source of verification is reduction of departures fostered children and young people from data from the archive of the families with a current 30% to Centre for Social Welfare 20-25% (reduction of 5-10%)
  • 21.
    Defining the risksand assumptions - the fourth column of the logframe FOURTH COLUMN - defined assumptions (from bottom to top for each level of objectives) - Assumptions what could disrupt the implementation of the project or affect its performance, and the fact that we can’t influence on that? -To fill a column of assumptions is necessary: -define the risks that are contained in each activity -converting the identified risks in the assumptions - Precondition is the assumption that must be filled in order to started on the activities
  • 22.
    Defining the risksand assumptions - the fourth column of the logframe Description of the action Objectively verifiable Source and means of Assumptions indicators of achievement verification Positive or negative external factors 1 8 9 Overall objectives What are the key indicators of the project affecting the success What are the sources of What are the overall broader related to the outside the influence of the which are overall information for these objectives to which the action objectives? They must be complied in project. indicators? will contribute? order to succeeded the project (eg, 2 10 Specific objectives Which indicators economic 11 are the sources of political and clearly show situation in the What 7 Which factors and conditions outside What specific objjective is the country, weather conditions, etc.) exist or can that the objective of the action information that of Beneficiary’s responsibility are necessary to achieve that objective? action intended to achieve to has been achieved? be collected? What are the (external coditions) Which risks contribute to the overall methods requred to get this should be taken into consideration? objectives? information? Conditions 3 12 13 6 Expected results outside ofare the sources of What are the indicators to What the What external conditions must The results are the output projectinformation about action measure whether and to what that will be met to obtain expected envisaged to achieve the specific extent the action achieves the progress? results on schedule? objective. What are the expected expected results? impact timing results? Enumerate them 4 14 15 5 Activities Means Which external Costs What pre-conditions are What are the key activities to What are the means required What are the action costs? required before the action be carried on and in what conditions must be to implement these activities, How are they classified? starts? What conditions sequence in order to produce e.g. personnel, equipment, (breakdown in the Budget for outside the Beneficiary’s direct the expected results? (group complied before training, studies, supplies, the action) control have to be met for the the activities by result) implementation of operational facilities, etc. implementation of the planned activities? planned activities?
  • 23.
    Example of definingthe risks and assumptions - the fourth column of the logframe Intervention logic Objectively verifiable indicators Sources of verification Assumptions What are the overall broader Overall objectives to which the action will What are the key indicators objective contribute? related to the overall objectives? Increasing the employability of Increased employability of blind blind people on the open labor people by 5% within one year after market completion of the project What specific objjective is the Which factors and conditions outside action intended to achieve to Which indicators clearly show that of Beneficiary’s responsibility are Specific contribute to the overall the objective of the action has What are the sources of necessary to achieve that objective? objectives objectives? been achieved? information for these indicators? (external coditions) 1/3 of visitors receives the Unemployed blind people will be 1. Increasing the level of working certificate interested in this type of training competence of blind people Which risks should be taken into Project report consideration? It was done 20 interviews for Employers will have no interest to the employment of unemployed become informed and gain 2. Sensitization of unemployed blind people. knowledge about the potential of blind people and employers blind people
  • 24.
    Results 30 unemployed blind people 1.1 Increased number of trained have passed the specific unemployed blind persons training Risks 2.1 Increased awareness of the 30 blind people have passed Blind unemployed people will needs of blind people to their entry the workshop and are ready not be interested in this type of into the open labor market for the job training 2.2 Increased number of employers Employers will have no interest who have recognized the potential At least 50 employers who Project reports, independent to inform and gain knowledge surveys about the potential of blind of blind people were on the stands people Activities Means/Resources Cost Assumptions 1.1.1 Education for blind Human resources 1.1.1.1 Organizing training about consultants, trainers, Travels the needs equipment needed for Equipment training, transportation, 1.1.1.2 Implementation of catering, supplies Services training Other 2.1.1 Education about rights and There is a methodology for opportunities for employment of Total training blind people in the OTR consultants, trainers, Required coaches are equipment needed for available 2.1.1.1 Organizing workshops Particular area for training is training, transportation, about the needs available at the time and at a catering, supplies 2.1.1.2 implementation of price that is provided workshops 2.2.1 Increase awareness of consultants, trainers, employers equipment needed for 2.2.1.1 Organizing workshops training, transportation, for employers by employment catering, supplies opportunities for blind people

Editor's Notes

  • #4 The elements of analysis:Stakeholder analysis - all individuals, groups, institutions or companies that may have a significant interest in the success or failure of the projectAnalysis of problemsAnalysis of individual objectivesAnalysis of strategy - comparison of various options for solving problems and achieving the set objectivesPhases of planning and project management - results of the analysis are carried in a practical, operational plan. At this stage - prepares of logical framework, defines requirements, plans for resources and activities and prepares of budgets.
  • #6 While technically, the numbers indicate the suggested “order” in which the matrix should be completed, the arrows represent the need to also have a sound “reverse logic”. The next slides puts it simply.
  • #12 The scheduleofactivities needs to be completed on the following way:list the most important activities needed to implement the project- breakdown identified activitiesin the sub-activitiesIdentify the order in which sub-activities should be undertakenIdentify which sub-activity should becompleted first in order to facilitate the implementation of some other sub-activitiesSpecify the duration of each sub-activities and define the beginning and end of each sub-activitiesAssess the costs ofimplementing ofeach activityDefine the human resources required for implementation of identified activities- distribute the tasks to project team
  • #22 ASSUMPTIONS - positive or negative external factors affecting the success of the project but there are outside the influence of the project. They must be complied in order to succeeded the project (eg, political and economic situation in the country, weather conditions, etc.)What are the factors, other than the responsible users, that are important for achieving the goal? What risks should be taken into account?PRECONDITION - which external conditions must be complied before implementation of planned activities?
