1. Elemental Cost Analysis
GROUP E
Group Members :
Calvin Wong Kim Ming 0323642
Chan Wei Lun 0326117
Ee Hui Teng 0322548
Fong Kah Yan 0322815
Gillian Chong Yeong Lin 0323941
Koh Ee Sing 0323855
Kok Ka Shing 0323553
Loh Mun Tong 0323680
Loh Wen Jun 0323551
Muhammad Fareez 0322961
Sew Yue Ling 0327032
Tan Jia San 0322406
Vivian Chin Kha Yee 0331228
Yeong Poh Ling 0323590
2. PROJECT DETAILS

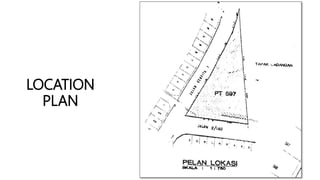

Address: Above Lot 597, Jalan Gempita 1, Taman Salak Selatan Mukim Petaling, Kuala
Lumpur
Building Purposes: Residential
Type of Project: Private
Contract Information: PAM, Private Edition (without quantities)
Contract Period Stipulated by Client: 52 weeks
Gross Floor Area: 2023.398 m²
18. Gross Floor Area: 336.219 m²
Per floor
Block B
(First Floor and Second Floor)
19. Total Gross Floor Area
Location Block A Block B
Total Gross Floor Area
(m²)
Ground Floor 338.247 336.219 674.466
Upper Floors 676.494 672.438 1348.932
Gross Floor Area 2023.398
20. Total area of all enclosed spaces fulfilling the main
functional requirements of the building (e.g. office
space, shop space, public house drinking area, etc.).
USABLE
26. Total area of all enclosed spaces for lavatories,
cloakrooms, kitchens, cleaner’s rooms, lift, plant and
tank rooms and the like, supplementary to main
function of the building.
ANCILLARY
28. The area occupied by partitions, columns, internal
structure or party walls.
Note : The sum of the areas falling in the categories
defined above wil equal the Gross Floor Area.
INTERNAL DIVISION
29. Block A
(Ground Floor, First
Floor & Second
Floor)
Internal Division:
44.824 m²
Internal Partition Wall
Internal Wall
30. Block B
(Ground Floor, First
Floor & Second
Floor)
Internal Division:
44.824 m²
Internal Partition Wall
Internal Wall
31. Total Gross Floor Area
Location Block A Block B Total Area (m²)
Usable Area 878.081 866.137 1744.218
Circulation Area 91.836 94.062 185.898
Ancillary Area N/A N/A N/A
Internal Division 44.824 48.458 93.282
Gross Floor Area 2023.398
33. 𝐄𝐱𝐭𝐞𝐫𝐧𝐚𝐥 𝐖𝐚𝐥𝐥 𝐀𝐫𝐞𝐚
𝐆𝐫𝐨𝐬𝐬 𝐅𝐥𝐨𝐨𝐫 𝐀𝐫𝐞𝐚
=
𝟐𝟎𝟕𝟎.𝟏𝟒𝟐
𝟐𝟎𝟐𝟑.𝟑𝟗𝟖
m²
= 1.023
Functional Unit: 1744.218 m²
External Wall Area
Block A - 1103.536
Block B - 966.606
34. Storey Heights
• Average Below Ground
Floor: N/A m
• At Ground Floor: 3.05m
• Above Ground Floor:
6.10m
35. Design / Shape:
Percentage of gross floor area:
A) Below Ground Floor: N/A%
B) Single - Storey Construction: N/A %
C) Two - Storey Construction: N/A %
D) Three - Storey Construction: 100%
36. Brief Cost Information
Contract Sum: (RM) 1,588,044.50
Provisional Sums: (RM) 165,879.00
Prime Cost Sums: (RM) 0.00
Preliminaries: (RM) 80,000.00 being 5.30 %) of remainder
Contingencies: (RM) 80,000.00 being 5.60 %) Contract Sum
Contract Sum
less Contingencies: (RM) 1,508,044.50
Functional Unit Costs excluding
external works: RM 729.95/ m²
37. Discount and Rationalisation
Total Contract Sum RM 1,598,044.50
Contingency RM (80,000.00)
Provisional Sum RM (165,879.00)
RM 1,352,165.50
Total discount = RM 10,000.00
Discount =
10,000.00
1,352,165.50
× 100%
= 0.73955444%
After discount = RM 1,588,044.50
50. • Hand railing and staircase finishes2.D. Stairs
RM 14,140.00 RM 8,240.00 RM 22,380.00
RM 41,928.70Total cost of element
After discount RM 41,618.61
