New Trends in Construction Management
Construction Management
Construction Technology
Construction Planning and Management Systems using Primavera
Fundamentals of Construction Costs and Estimating
Plumbing Systems I: Code and Engineering
Construction Changes and Claims Documentation
Legal Aspects of Construction Projects and Contracts
Principles of Structural Analysis
Advanced Estimating and Management of Project Costs in the Preconstruction and Construction Phases
Construction Surveying and Metrics
Construction Budget and Cost Control
Construction Job Site Management
Construction Project Management Using MS Project
Reading Construction Blueprints
Electrical Design and Construction
The Solar Energy Solution: Harnessing Solar Power in the Home and Office
Leadership in Energy and Environmental Design
Introduction to Building Information Modeling
Construction Estimating and Design Analysis Using BIM
Land Development Procedures
New Trends in Construction Management
Construction Management
Construction Technology
Construction Planning and Management Systems using Primavera
Fundamentals of Construction Costs and Estimating
Plumbing Systems I: Code and Engineering
Construction Changes and Claims Documentation
Legal Aspects of Construction Projects and Contracts
Principles of Structural Analysis
Advanced Estimating and Management of Project Costs in the Preconstruction and Construction Phases
Construction Surveying and Metrics
Construction Budget and Cost Control
Construction Job Site Management
Construction Project Management Using MS Project
Reading Construction Blueprints
Electrical Design and Construction
The Solar Energy Solution: Harnessing Solar Power in the Home and Office
Leadership in Energy and Environmental Design
Introduction to Building Information Modeling
Construction Estimating and Design Analysis Using BIM
Land Development Procedures
5 Steps of Generating Clash Report Using NavisworksUnited-BIM
Clash detection via Building Information Modeling (BIM) helps in speeding up projects by identifying clashes between several models during the design stage itself, helping architects and contractors eliminate chances of multi-level design changes which can result into budget overshoot and delay in project completion time.
In this slide, you will learn how the clash report is generated through Navisworks.
Project
A Project is defined as a temporary endeavour undertaken to create a unique product/service/results.
Product
The product in case of a construction project is the constructed facility such as a building, a bridge, a highway, a dam, a canal, a factory etc.
This is a paper presentation on construction supervision delivered to a body of professionals in the construction industry at a seminar in Lagos state, Nigeria in May, 2015.
Construction Management Introduction pptRajeshPV12
DEFINITION OF PROJECT, CONSTRUCTION,CONSTRUCTION PROJECT, PROJECT MANAGEMENT AND CONSTRUCTION MANAGEMENT.1.1.0 Understand the importance and functions of management in construction projects and various elements involved in it.
1.1.1 Explain the salient features of construction projects.
1.1.2 List different types of construction projects.
1.1.3 Identify various elements of construction projects
. 1.1.4 Identify the activities performed by construction industry.
1.1.5 Illustrate the functions of construction management.
UNIT 1 INTRODUCTION | CE8022 PREFABRICATION STRUCTURES |Venkateswaran S
Presented about topics of Need for prefabrication – Principles of prefabrication – Modular coordination – Standarization – Materials – Systems – Production – Transportation – Erection as per anna university. CE8022 Prefabrication structures
5 Steps of Generating Clash Report Using NavisworksUnited-BIM
Clash detection via Building Information Modeling (BIM) helps in speeding up projects by identifying clashes between several models during the design stage itself, helping architects and contractors eliminate chances of multi-level design changes which can result into budget overshoot and delay in project completion time.
In this slide, you will learn how the clash report is generated through Navisworks.
Project
A Project is defined as a temporary endeavour undertaken to create a unique product/service/results.
Product
The product in case of a construction project is the constructed facility such as a building, a bridge, a highway, a dam, a canal, a factory etc.

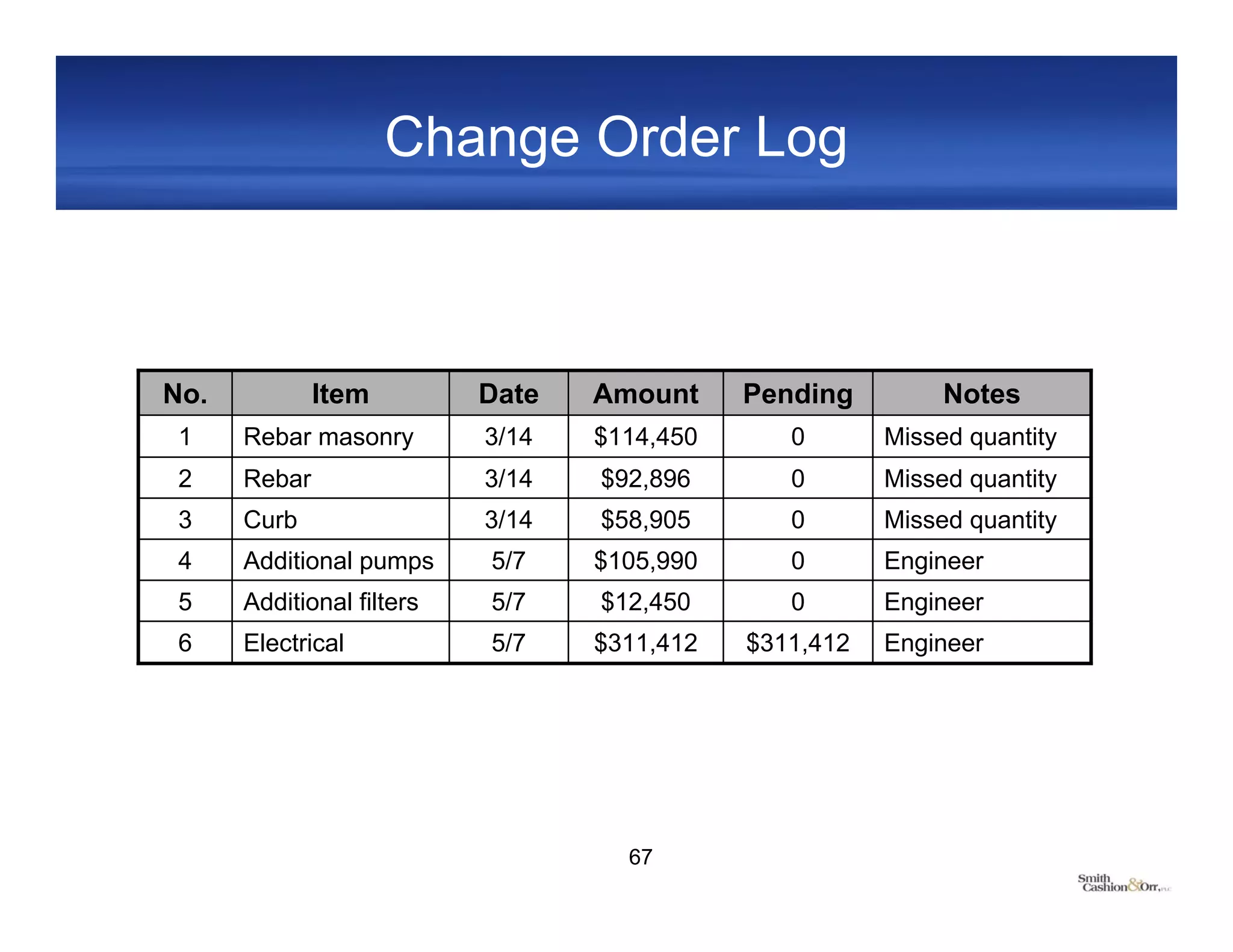

This is a paper presentation on construction supervision delivered to a body of professionals in the construction industry at a seminar in Lagos state, Nigeria in May, 2015.
Construction Management Introduction pptRajeshPV12

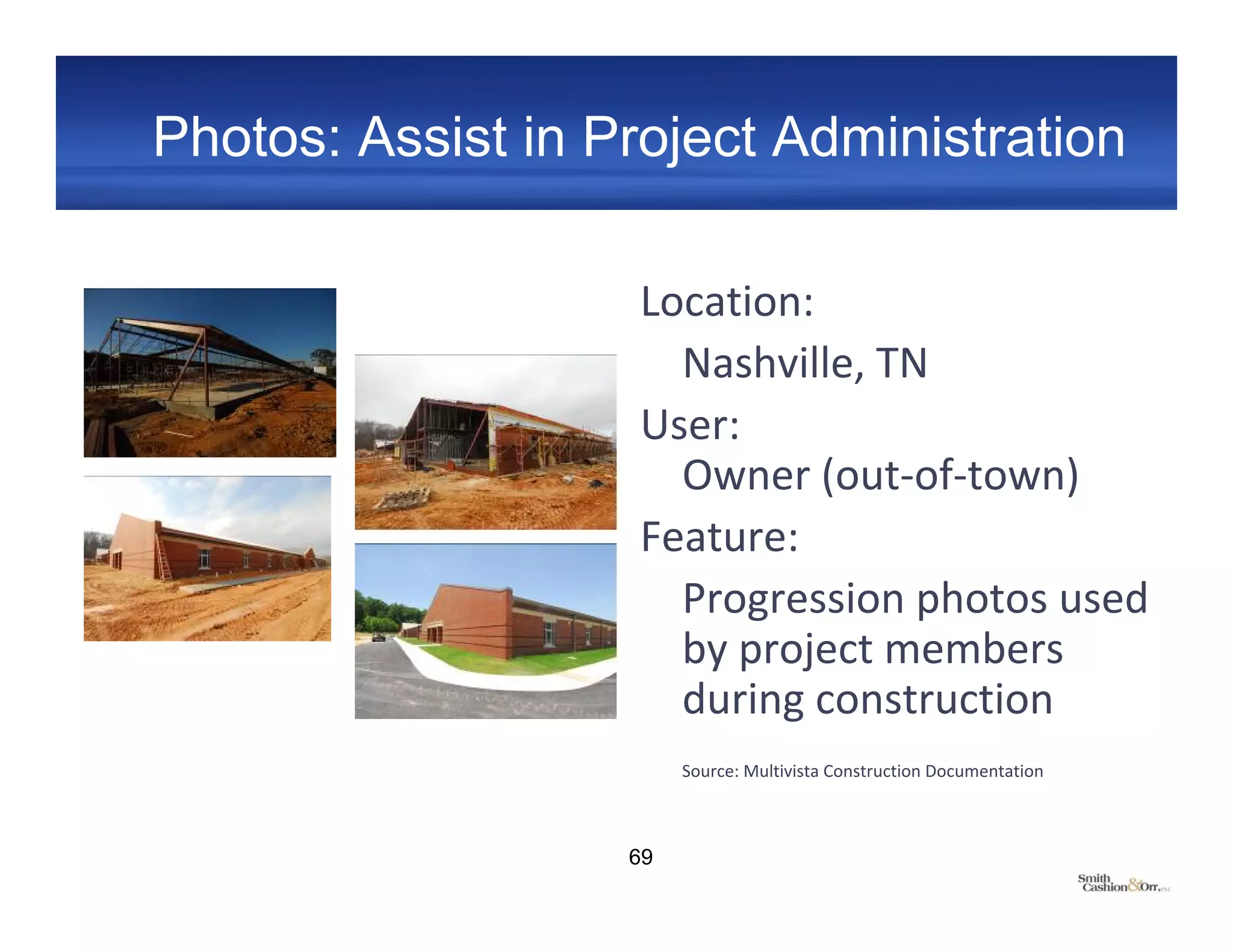

DEFINITION OF PROJECT, CONSTRUCTION,CONSTRUCTION PROJECT, PROJECT MANAGEMENT AND CONSTRUCTION MANAGEMENT.1.1.0 Understand the importance and functions of management in construction projects and various elements involved in it.
1.1.1 Explain the salient features of construction projects.
1.1.2 List different types of construction projects.
1.1.3 Identify various elements of construction projects
. 1.1.4 Identify the activities performed by construction industry.
1.1.5 Illustrate the functions of construction management.
UNIT 1 INTRODUCTION | CE8022 PREFABRICATION STRUCTURES |Venkateswaran S
Presented about topics of Need for prefabrication – Principles of prefabrication – Modular coordination – Standarization – Materials – Systems – Production – Transportation – Erection as per anna university. CE8022 Prefabrication structures

In Pharma and Biotech, Weightage of the Documentation is around 70 % because as per FDA "If you do not have Document, You dint have do it."
So Good Documentation Practice is of tremendous importance for the Industry to comply any regulation like FDA, GMP or ISO.

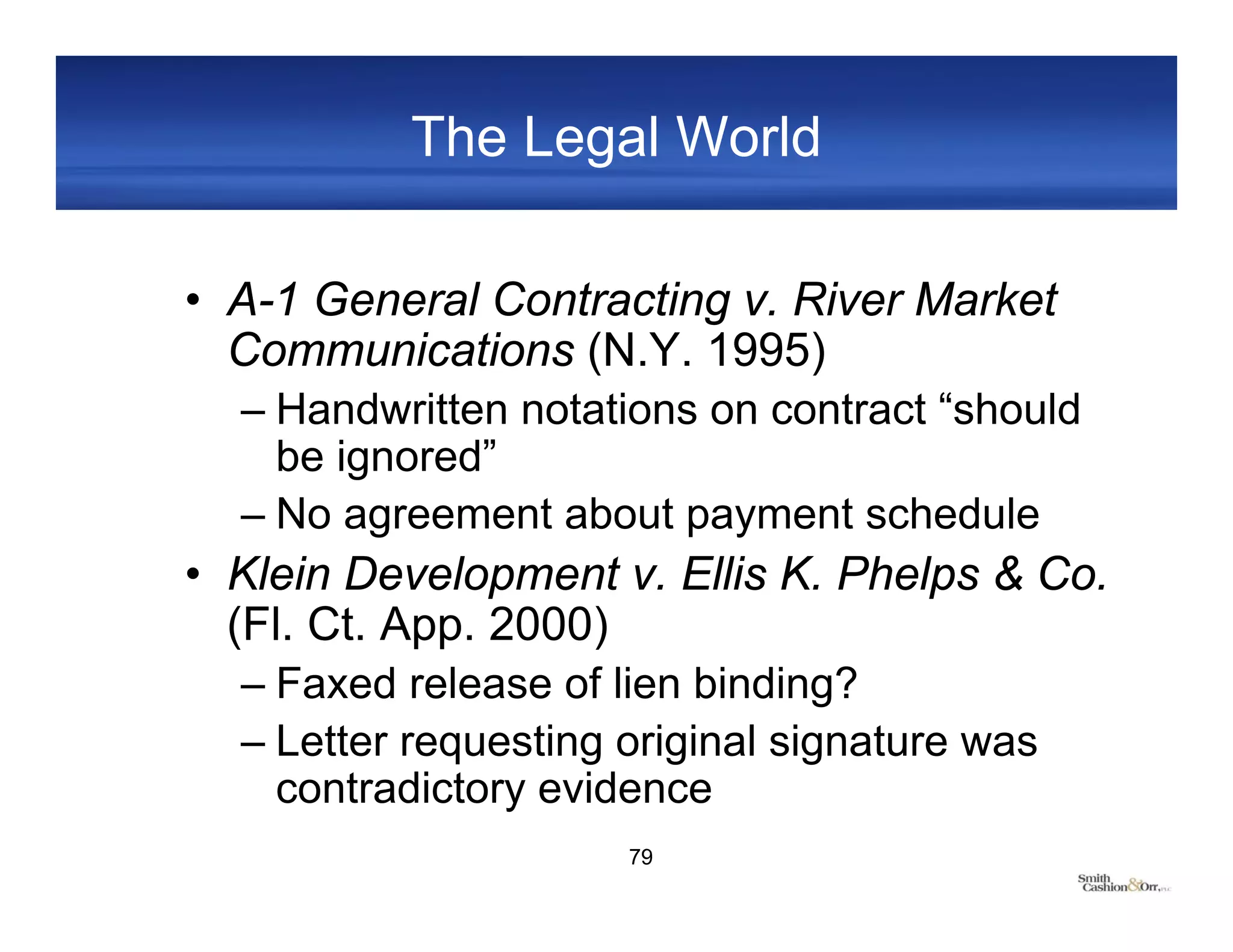

Friends, this ppt consists of various facets of construction management and equipment such as how to buy equipments, its various types and Depreciation and lastly why and how to replace equipments.

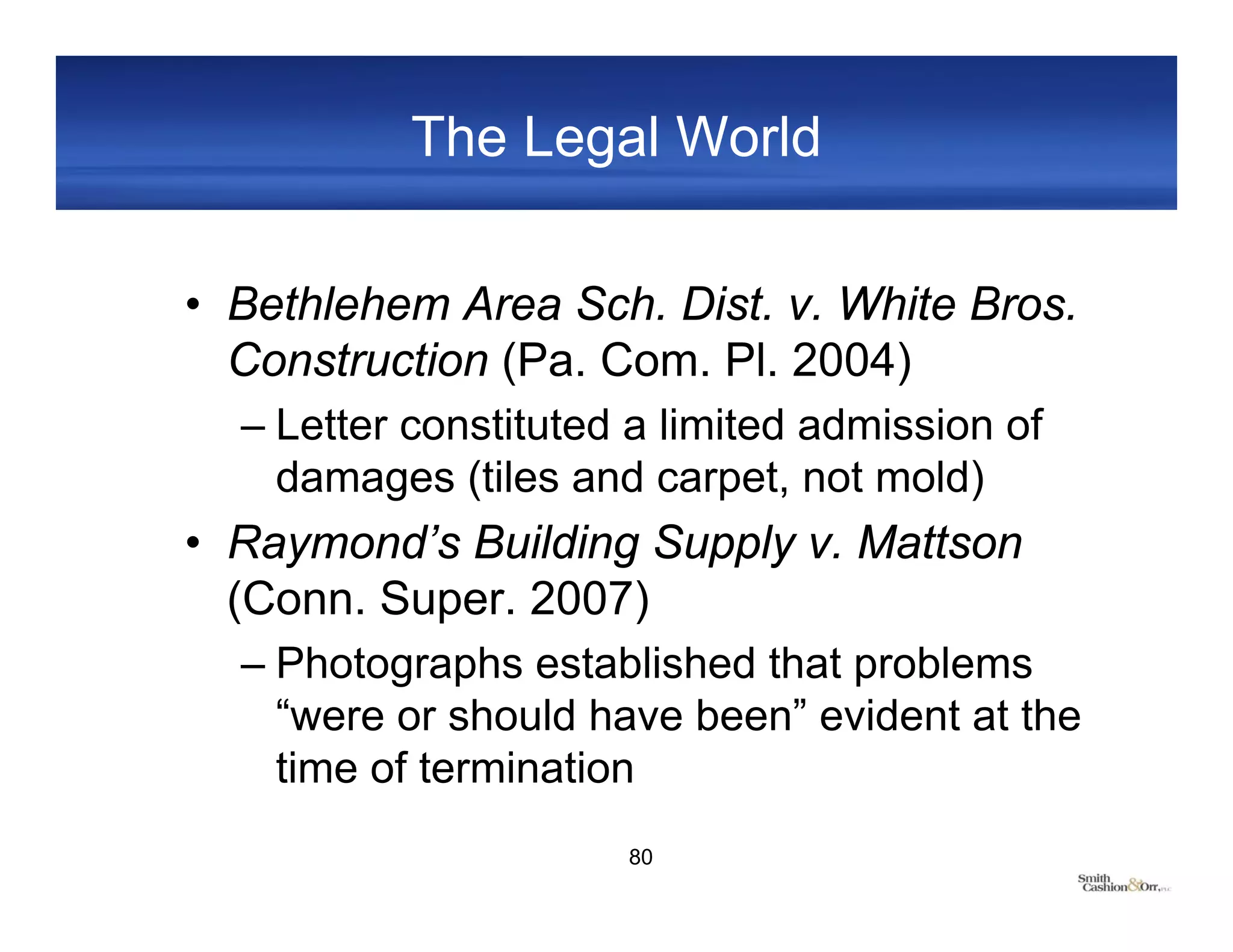

A brief introduction and overview of construction management and its application. A guidance for civil engineers teachers and students.
To get these slides please visit
http://www.xubitech.com/
Advanced Training for Construction Management: CONTRACTS MANAGEMENT part1Antonio Coladarce
PART 1 is dedicated to an overview of CONTRACTS MANAGEMENT (active and passive contracts, i.e. those with final customers and with subcontractors, respectively).
Presentation is prepared for an advanced course dedicated to Construction Management, refer to PART 2 also
On February 16, construction law attorney, Mike Madigan hosted an in-house seminar discussing construction claim management + project documentation. The seminar focused on the steps to make a claim, key project documentation considerations, and dealing with a claim from the perspectives of the owner, the CM, and the subcontractor.
This is a presentation I gave at the 2007 PMI NCR Symposium on how to conduct a Project Audit. Contact me at Larry.Cooper@IGPLI.Net if you have questions.
IWMW 2004: It Always Takes Longer Than You Think (Even If You Think It Will T...IWMW
Slides used in workshop session B1 on "It Always Takes Longer Than You Think (Even If You Think It Will Take Longer Than You Think)" at the IWMW 2004 event held at the University of Birmingham on 27-29 July 2004.
See http://www.ukoln.ac.uk/web-focus/events/workshops/webmaster-2004/sessions/walker/
How Strategic Alliances and Alternative Delivery Models Drive Project Success...Aconex
In this webinar, Hans Hoppe of Parsons and Norman Anderson, CEO of CG/LA discussed how leading organizations are using strategic alliances, alternative delivery models and new financing approaches to successfully deliver complex projects.
3 Ways That Data Helps Reduce Review Cycles - Webinar, May 2016Aconex
In this webinar, Roger Gagnier P.E., Vice President at AECOM, discussed how accessible and up to date data can be the key to streamlining project processes. We share best practices you can take directly back to your project team.
Project Management: Choosing the Right Tools and ApproachPeter Campbell
Different projects require difgferent approaches. It's not a matter of which is better - traditional Waterfall or the newer agile approach -- it's a matter of what type of project your doing,. This NTEN presentation discusses both approaches and advises on when each one might work, as well as discussing what software will help.
Everything You Need to Know About Planning and Executing Your Next Laboratory...Triumvirate Environmental
Laboratory relocations are inherently disruptive to an organization and can be hectic given how many people in the organization are affected, and the number of stakeholders required to pull off a successful relocation. Like any project, lab relocations require strong and competent project management to be successful in reducing the impact to the organization.
This presentation:
1. Introduces the concept and need of software project management.
2. Discusses the crucial role of project manager in the success and failure of a project.
3. Lays down the foundation for further training in project management area.
Business Case Strategies For Integrating Comissioning With Construction And P...mike benedetto
Presentation delivered at National CMAA Conference. Presentation outline considerations and business drivers supporting the integration of comissioning and qualification as part of project delivery strategy.
There are multiple project management methods that can be used to ensure a project’s specific objectives are delivered on time and on budget. To select the most effective project management strategy for your business, you need to know what each methodology involves and how they differ from one another.
Business Valuation Principles for EntrepreneursBen Wann
This insightful presentation is designed to equip entrepreneurs with the essential knowledge and tools needed to accurately value their businesses. Understanding business valuation is crucial for making informed decisions, whether you're seeking investment, planning to sell, or simply want to gauge your company's worth.
Skye Residences | Extended Stay Residences Near Toronto Airportmarketingjdass
Experience unparalleled EXTENDED STAY and comfort at Skye Residences located just minutes from Toronto Airport. Discover sophisticated accommodations tailored for discerning travelers.
Website Link :
https://skyeresidences.com/
https://skyeresidences.com/about-us/
https://skyeresidences.com/gallery/
https://skyeresidences.com/rooms/
https://skyeresidences.com/near-by-attractions/
https://skyeresidences.com/commute/
https://skyeresidences.com/contact/
https://skyeresidences.com/queen-suite-with-sofa-bed/
https://skyeresidences.com/queen-suite-with-sofa-bed-and-balcony/
https://skyeresidences.com/queen-suite-with-sofa-bed-accessible/
https://skyeresidences.com/2-bedroom-deluxe-queen-suite-with-sofa-bed/
https://skyeresidences.com/2-bedroom-deluxe-king-queen-suite-with-sofa-bed/
https://skyeresidences.com/2-bedroom-deluxe-queen-suite-with-sofa-bed-accessible/
#Skye Residences Etobicoke, #Skye Residences Near Toronto Airport, #Skye Residences Toronto, #Skye Hotel Toronto, #Skye Hotel Near Toronto Airport, #Hotel Near Toronto Airport, #Near Toronto Airport Accommodation, #Suites Near Toronto Airport, #Etobicoke Suites Near Airport, #Hotel Near Toronto Pearson International Airport, #Toronto Airport Suite Rentals, #Pearson Airport Hotel Suites
Enterprise Excellence is Inclusive Excellence.pdfKaiNexus
Enterprise excellence and inclusive excellence are closely linked, and real-world challenges have shown that both are essential to the success of any organization. To achieve enterprise excellence, organizations must focus on improving their operations and processes while creating an inclusive environment that engages everyone. In this interactive session, the facilitator will highlight commonly established business practices and how they limit our ability to engage everyone every day. More importantly, though, participants will likely gain increased awareness of what we can do differently to maximize enterprise excellence through deliberate inclusion.
What is Enterprise Excellence?
Enterprise Excellence is a holistic approach that's aimed at achieving world-class performance across all aspects of the organization.
What might I learn?
A way to engage all in creating Inclusive Excellence. Lessons from the US military and their parallels to the story of Harry Potter. How belt systems and CI teams can destroy inclusive practices. How leadership language invites people to the party. There are three things leaders can do to engage everyone every day: maximizing psychological safety to create environments where folks learn, contribute, and challenge the status quo.
Who might benefit? Anyone and everyone leading folks from the shop floor to top floor.
Dr. William Harvey is a seasoned Operations Leader with extensive experience in chemical processing, manufacturing, and operations management. At Michelman, he currently oversees multiple sites, leading teams in strategic planning and coaching/practicing continuous improvement. William is set to start his eighth year of teaching at the University of Cincinnati where he teaches marketing, finance, and management. William holds various certifications in change management, quality, leadership, operational excellence, team building, and DiSC, among others.
Memorandum Of Association Constitution of Company.pptseri bangash
www.seribangash.com
A Memorandum of Association (MOA) is a legal document that outlines the fundamental principles and objectives upon which a company operates. It serves as the company's charter or constitution and defines the scope of its activities. Here's a detailed note on the MOA:
Contents of Memorandum of Association:
Name Clause: This clause states the name of the company, which should end with words like "Limited" or "Ltd." for a public limited company and "Private Limited" or "Pvt. Ltd." for a private limited company.
https://seribangash.com/article-of-association-is-legal-doc-of-company/
Registered Office Clause: It specifies the location where the company's registered office is situated. This office is where all official communications and notices are sent.
Objective Clause: This clause delineates the main objectives for which the company is formed. It's important to define these objectives clearly, as the company cannot undertake activities beyond those mentioned in this clause.
www.seribangash.com
Liability Clause: It outlines the extent of liability of the company's members. In the case of companies limited by shares, the liability of members is limited to the amount unpaid on their shares. For companies limited by guarantee, members' liability is limited to the amount they undertake to contribute if the company is wound up.
https://seribangash.com/promotors-is-person-conceived-formation-company/
Capital Clause: This clause specifies the authorized capital of the company, i.e., the maximum amount of share capital the company is authorized to issue. It also mentions the division of this capital into shares and their respective nominal value.
Association Clause: It simply states that the subscribers wish to form a company and agree to become members of it, in accordance with the terms of the MOA.
Importance of Memorandum of Association:
Legal Requirement: The MOA is a legal requirement for the formation of a company. It must be filed with the Registrar of Companies during the incorporation process.
Constitutional Document: It serves as the company's constitutional document, defining its scope, powers, and limitations.
Protection of Members: It protects the interests of the company's members by clearly defining the objectives and limiting their liability.
External Communication: It provides clarity to external parties, such as investors, creditors, and regulatory authorities, regarding the company's objectives and powers.
https://seribangash.com/difference-public-and-private-company-law/
Binding Authority: The company and its members are bound by the provisions of the MOA. Any action taken beyond its scope may be considered ultra vires (beyond the powers) of the company and therefore void.
Amendment of MOA:
While the MOA lays down the company's fundamental principles, it is not entirely immutable. It can be amended, but only under specific circumstances and in compliance with legal procedures. Amendments typically require shareholder
What is the TDS Return Filing Due Date for FY 2024-25.pdfseoforlegalpillers
It is crucial for the taxpayers to understand about the TDS Return Filing Due Date, so that they can fulfill your TDS obligations efficiently. Taxpayers can avoid penalties by sticking to the deadlines and by accurate filing of TDS. Timely filing of TDS will make sure about the availability of tax credits. You can also seek the professional guidance of experts like Legal Pillers for timely filing of the TDS Return.
The world of search engine optimization (SEO) is buzzing with discussions after Google confirmed that around 2,500 leaked internal documents related to its Search feature are indeed authentic. The revelation has sparked significant concerns within the SEO community. The leaked documents were initially reported by SEO experts Rand Fishkin and Mike King, igniting widespread analysis and discourse. For More Info:- https://news.arihantwebtech.com/search-disrupted-googles-leaked-documents-rock-the-seo-world/
3.0 Project 2_ Developing My Brand Identity Kit.pptxtanyjahb
A personal brand exploration presentation summarizes an individual's unique qualities and goals, covering strengths, values, passions, and target audience. It helps individuals understand what makes them stand out, their desired image, and how they aim to achieve it.
Falcon stands out as a top-tier P2P Invoice Discounting platform in India, bridging esteemed blue-chip companies and eager investors. Our goal is to transform the investment landscape in India by establishing a comprehensive destination for borrowers and investors with diverse profiles and needs, all while minimizing risk. What sets Falcon apart is the elimination of intermediaries such as commercial banks and depository institutions, allowing investors to enjoy higher yields.
Attending a job Interview for B1 and B2 Englsih learnersErika906060
It is a sample of an interview for a business english class for pre-intermediate and intermediate english students with emphasis on the speking ability.
Personal Brand Statement:
As an Army veteran dedicated to lifelong learning, I bring a disciplined, strategic mindset to my pursuits. I am constantly expanding my knowledge to innovate and lead effectively. My journey is driven by a commitment to excellence, and to make a meaningful impact in the world.
VAT Registration Outlined In UAE: Benefits and Requirementsuae taxgpt
Vat Registration is a legal obligation for businesses meeting the threshold requirement, helping companies avoid fines and ramifications. Contact now!
https://viralsocialtrends.com/vat-registration-outlined-in-uae/
Affordable Stationery Printing Services in Jaipur | Navpack n PrintNavpack & Print
Looking for professional printing services in Jaipur? Navpack n Print offers high-quality and affordable stationery printing for all your business needs. Stand out with custom stationery designs and fast turnaround times. Contact us today for a quote!

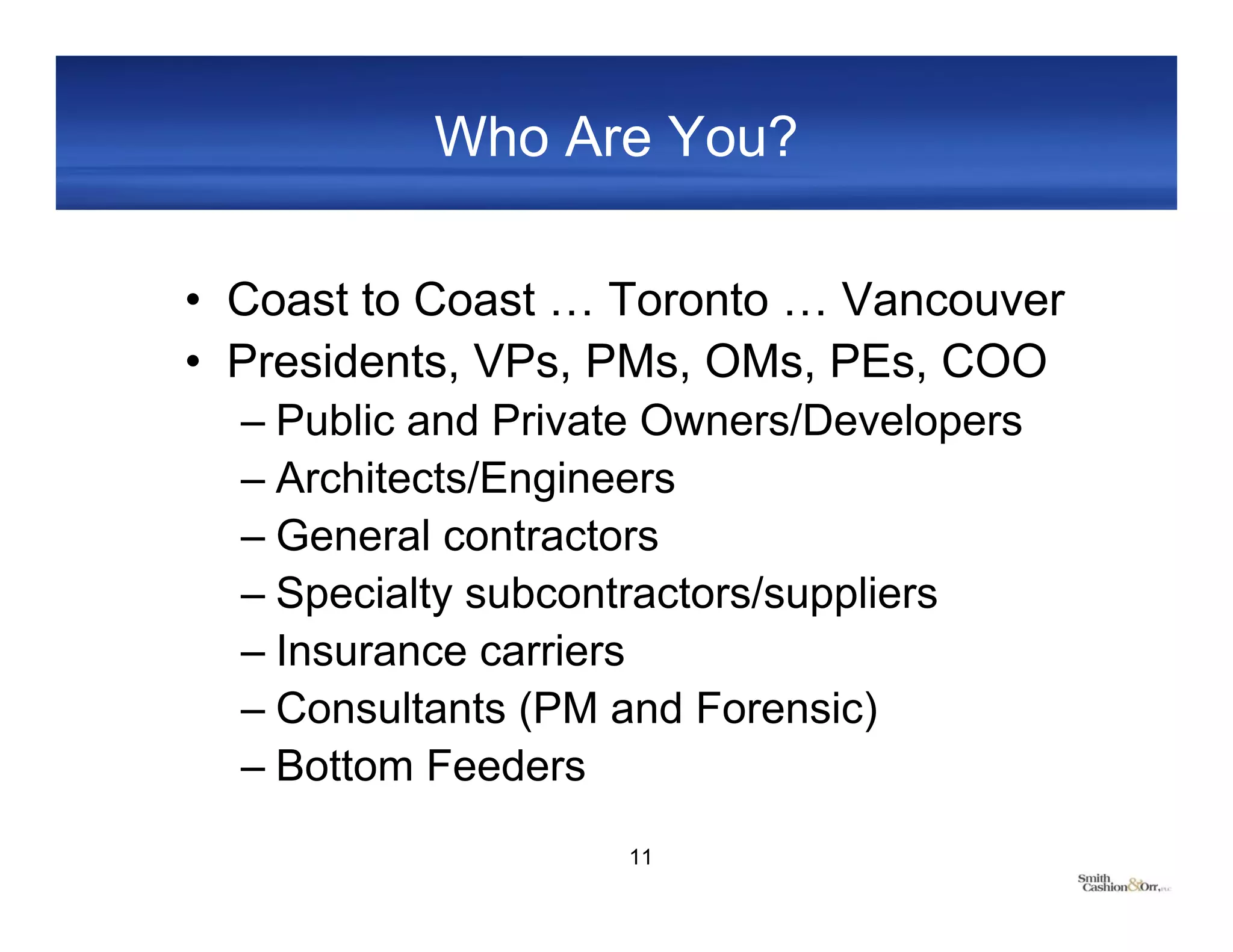

11. Who Are You?
• Coast to Coast … Toronto … Vancouver
• Presidents, VPs, PMs, OMs, PEs, COO
– Public and Private Owners/Developers
– Architects/Engineers
– General contractors
– Specialty subcontractors/suppliers
– Insurance carriers
– Consultants (PM and Forensic)
– Bottom Feeders
11
12. Who Am I?
• Construction Attorney, LEED ® AP,
Husband, Father of 5, Blogger, Author
12

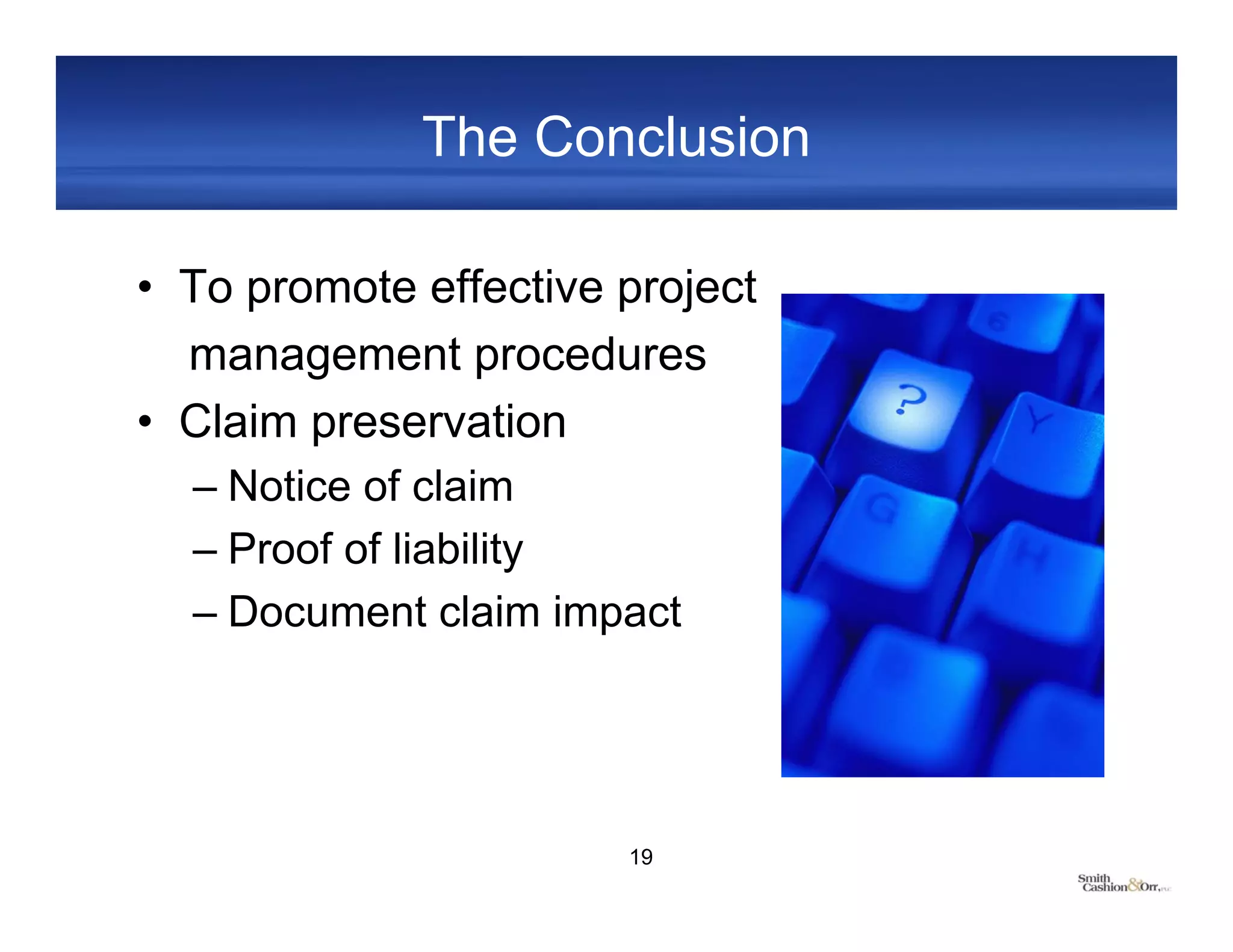

19. The Conclusion
• To promote effective project
management procedures
• Claim preservation
– Notice of claim
– Proof of liability
– Document claim impact
19

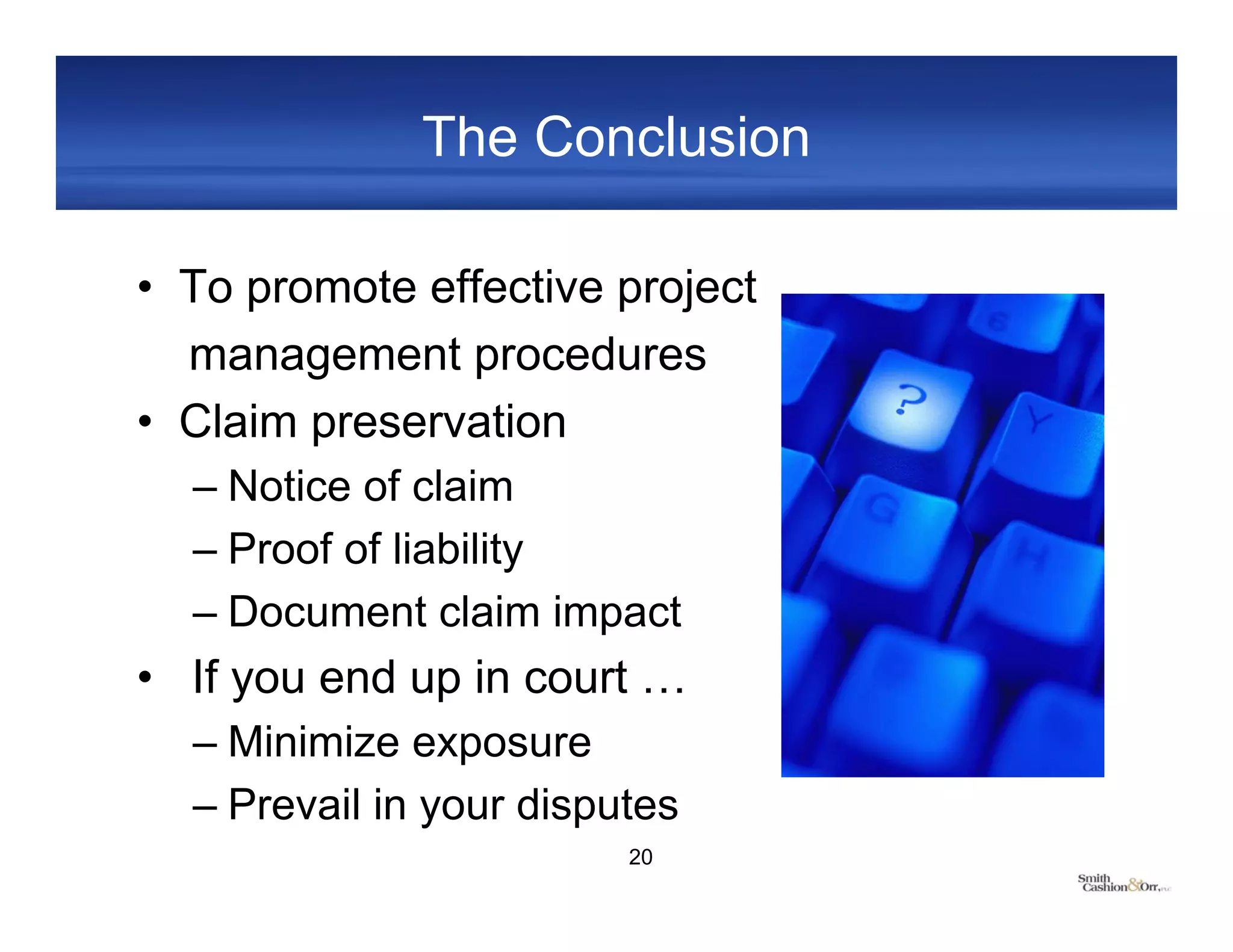

20. The Conclusion
• To promote effective project
management procedures
• Claim preservation
– Notice of claim
– Proof of liability
– Document claim impact
• If you end up in court …
– Minimize exposure
– Prevail in your disputes
20

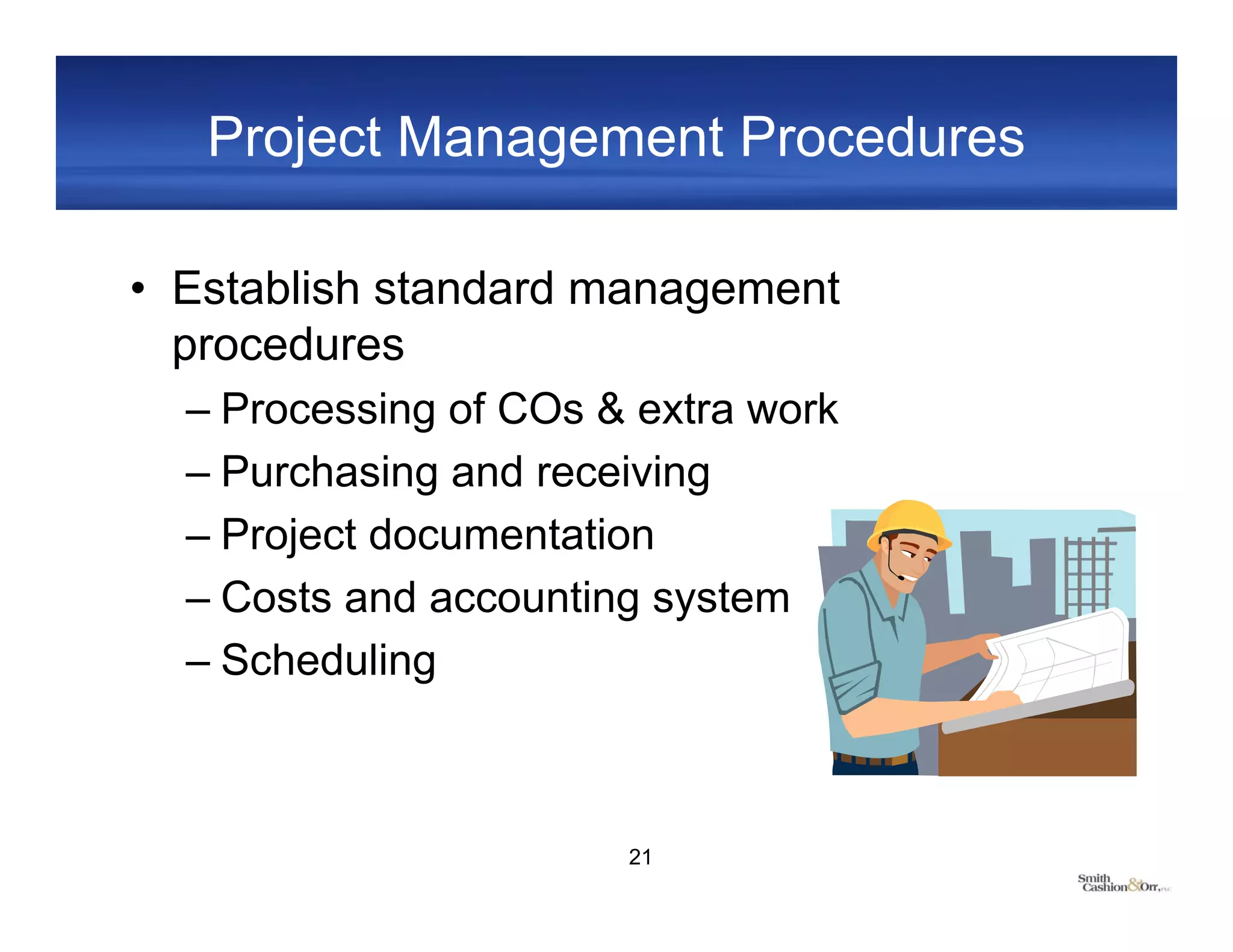

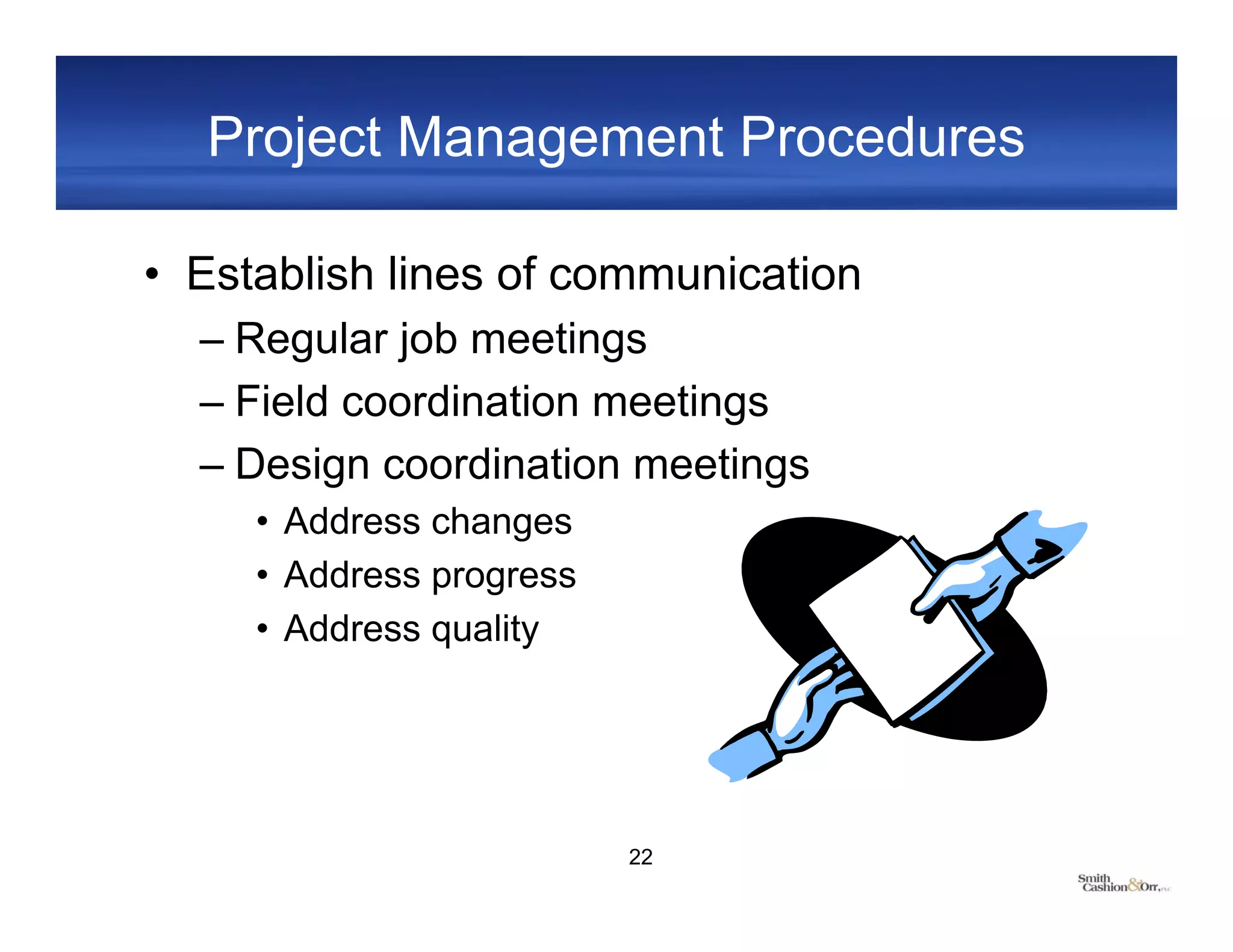

21. Project Management Procedures
• Establish standard management
procedures
– Processing of COs & extra work
– Purchasing and receiving
– Project documentation
– Costs and accounting system

– Scheduling
21

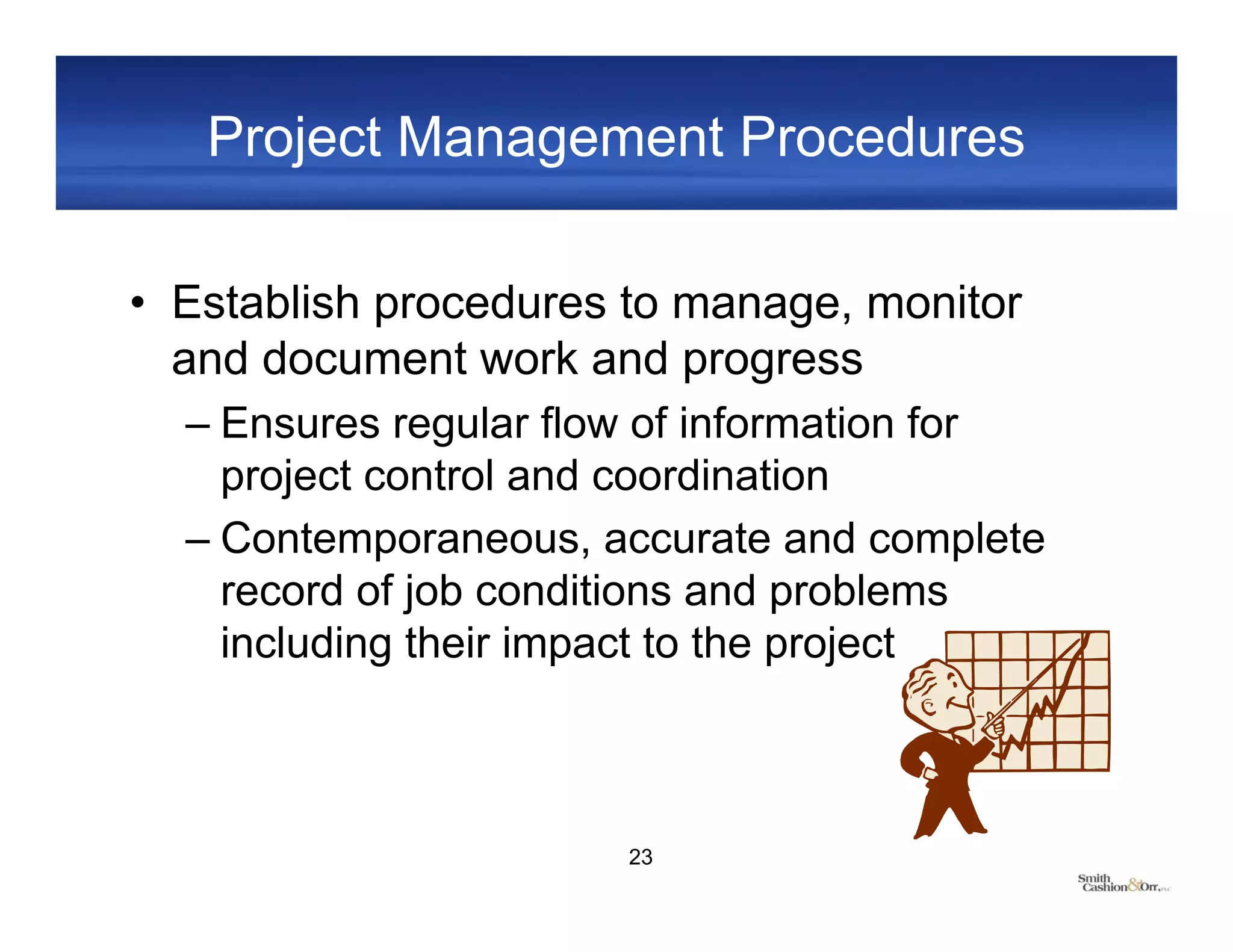

23. Project Management Procedures
• Establish procedures to manage, monitor
and document work and progress
– Ensures regular flow of information for
project control and coordination
– Contemporaneous, accurate and complete
record of job conditions and problems
including their impact to the project
23

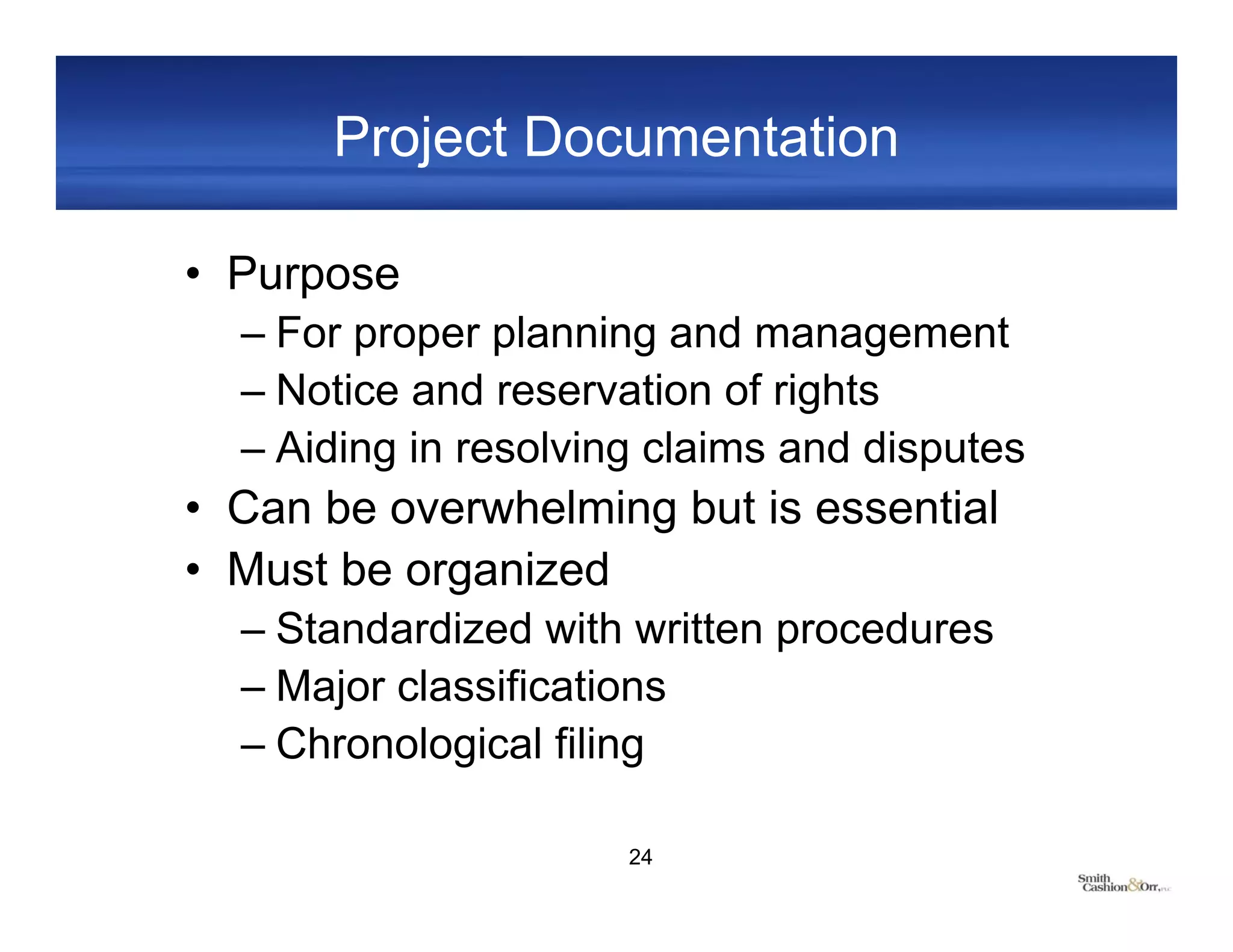

24. Project Documentation
• Purpose
– For proper planning and management
– Notice and reservation of rights
– Aiding in resolving claims and disputes

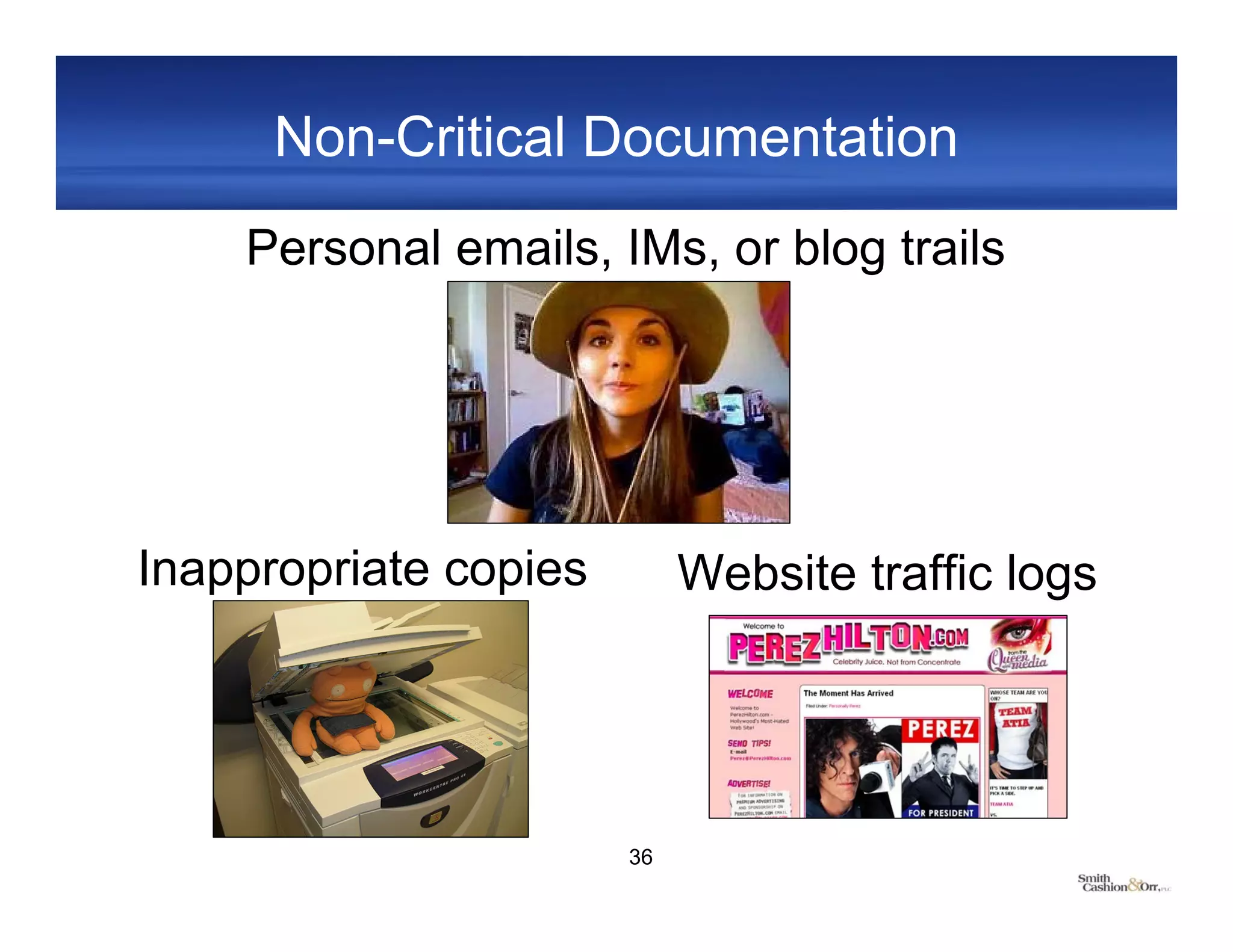

• Can be overwhelming but is essential
• Must be organized
– Standardized with written procedures
– Major classifications
– Chronological filing
24

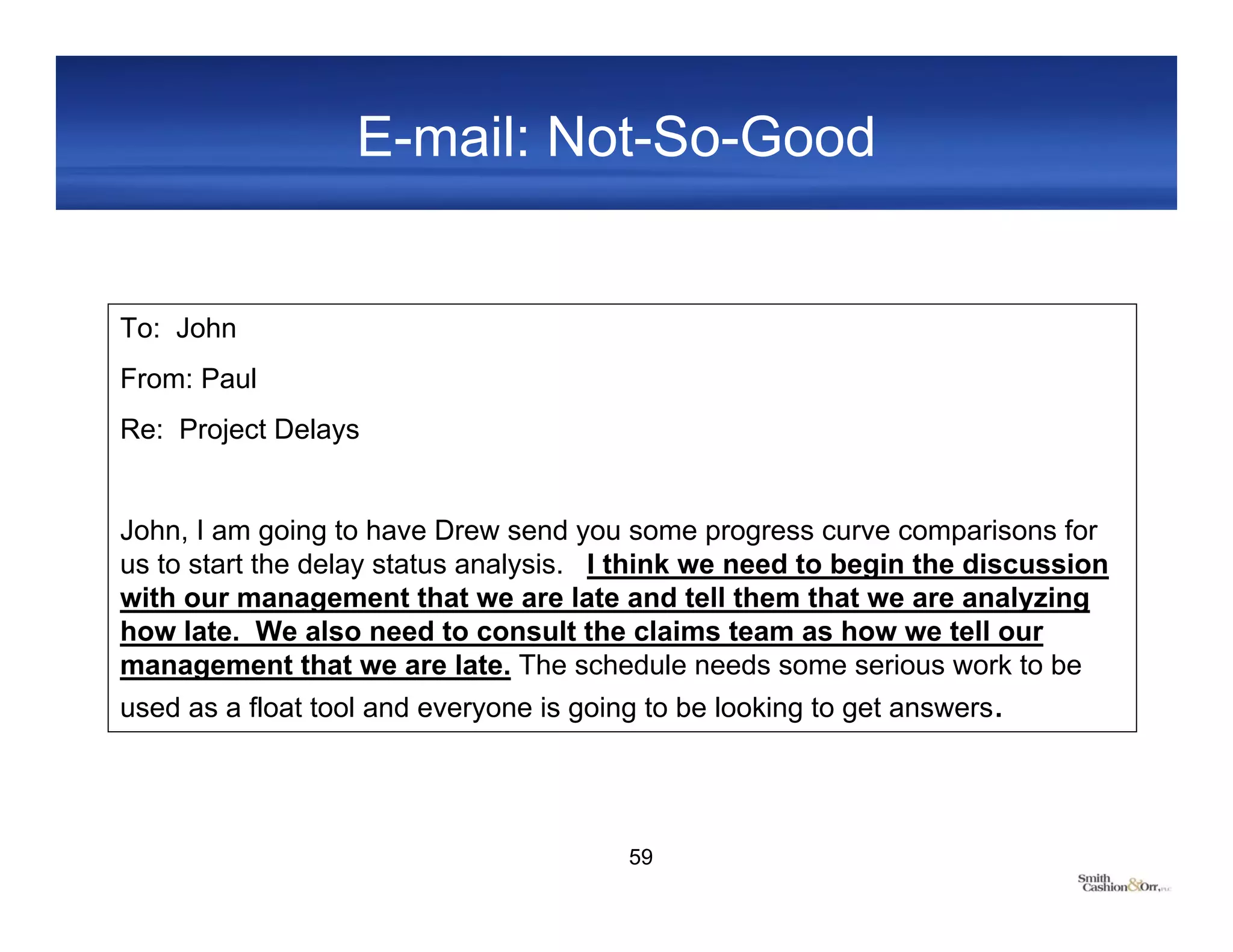

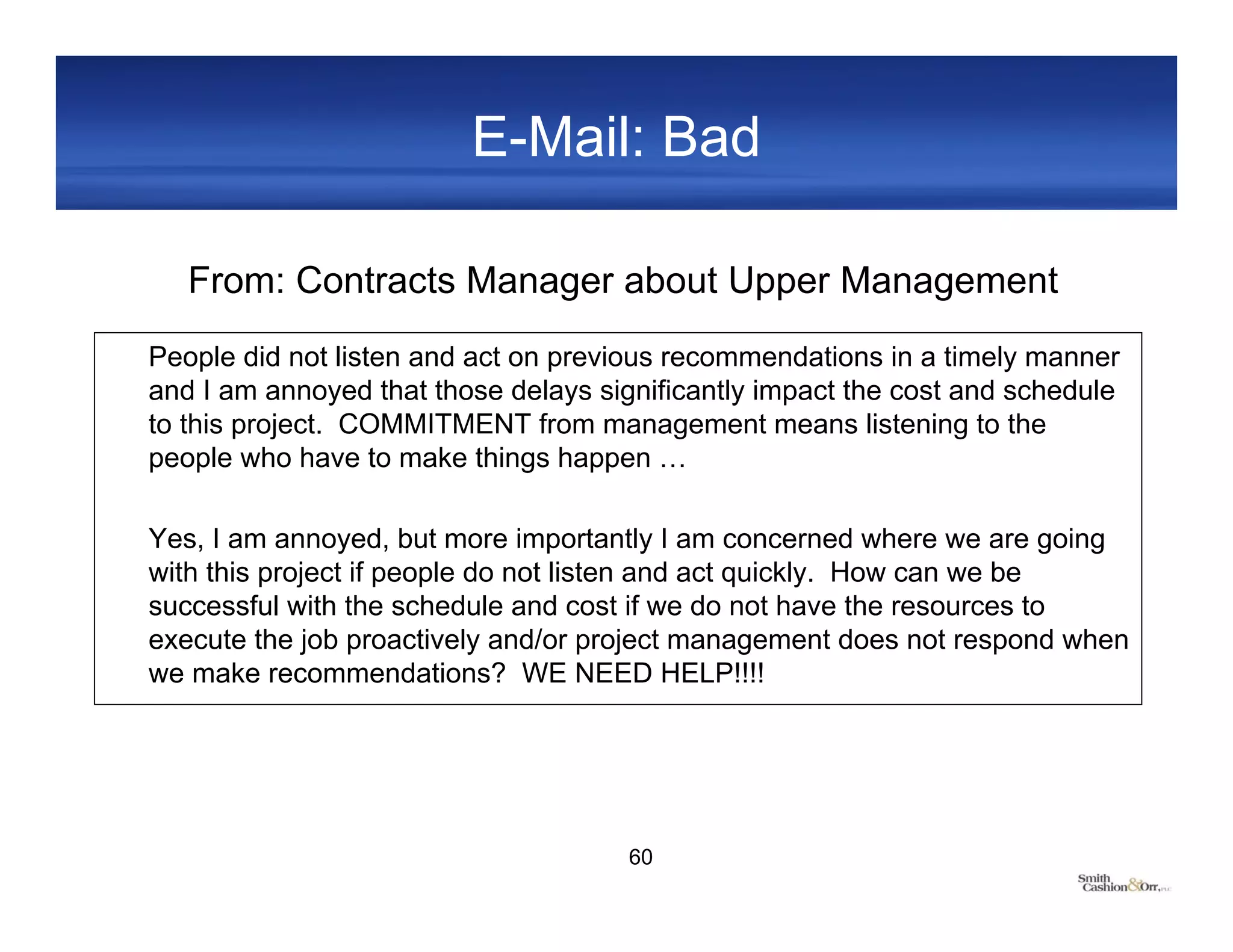

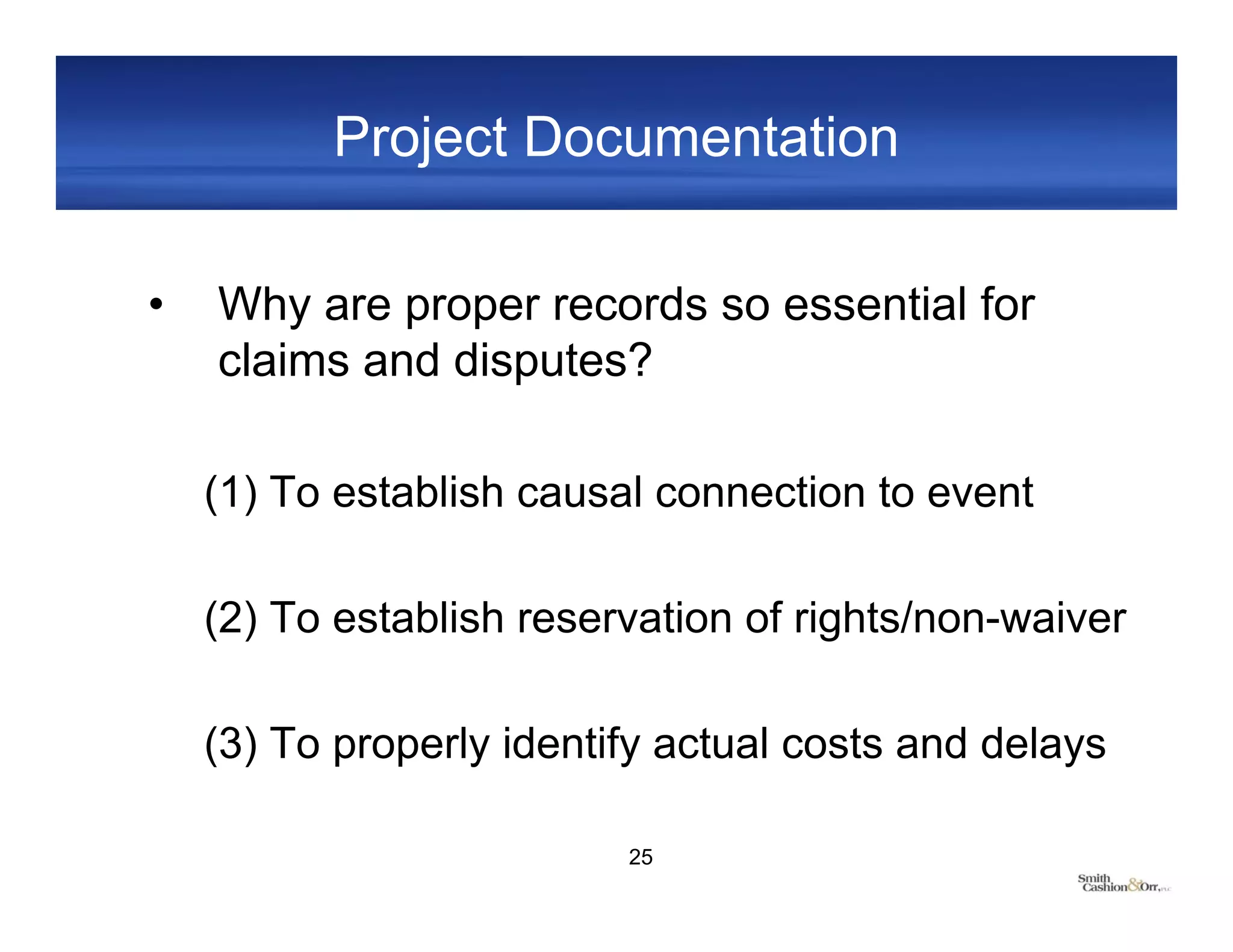

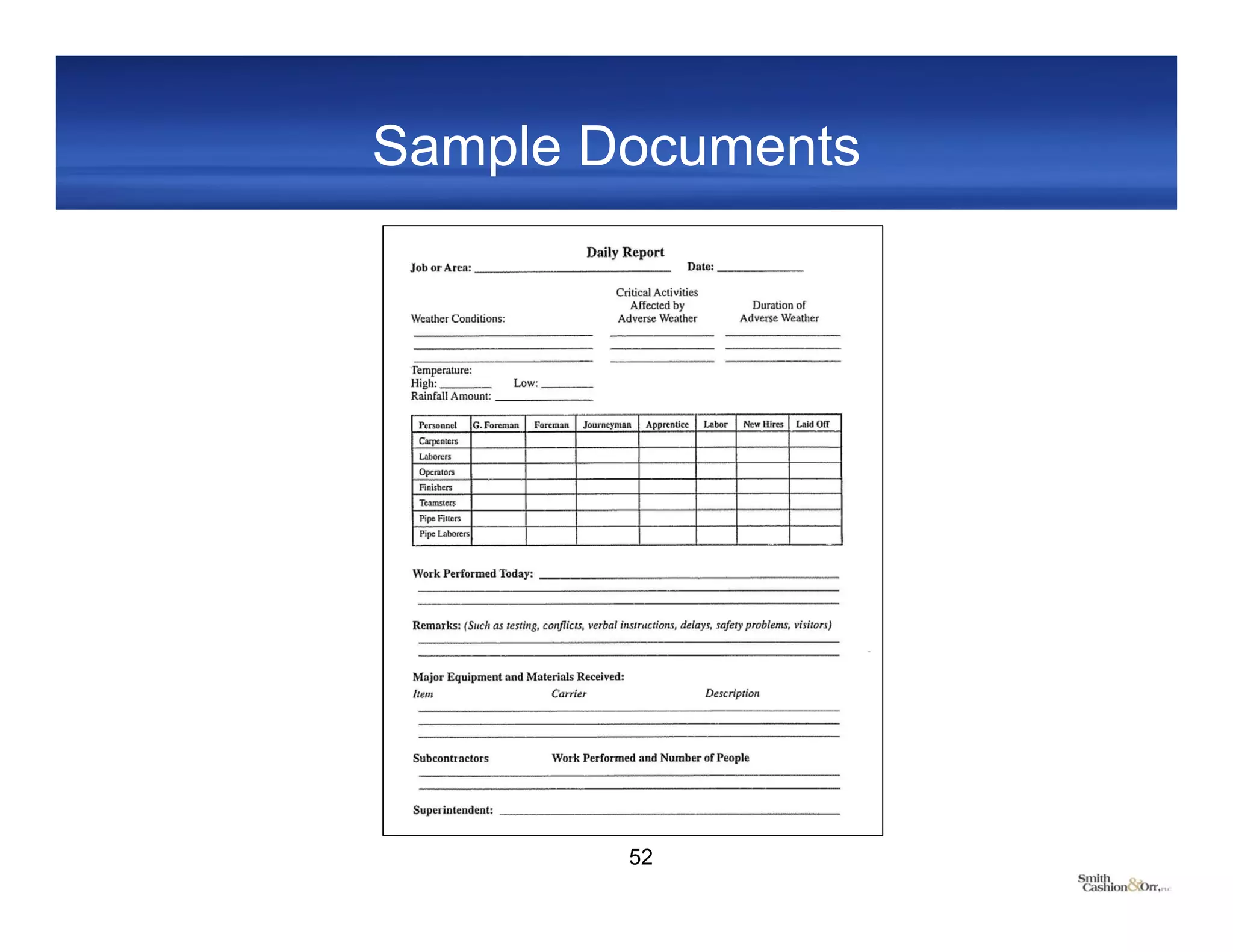

25. Project Documentation

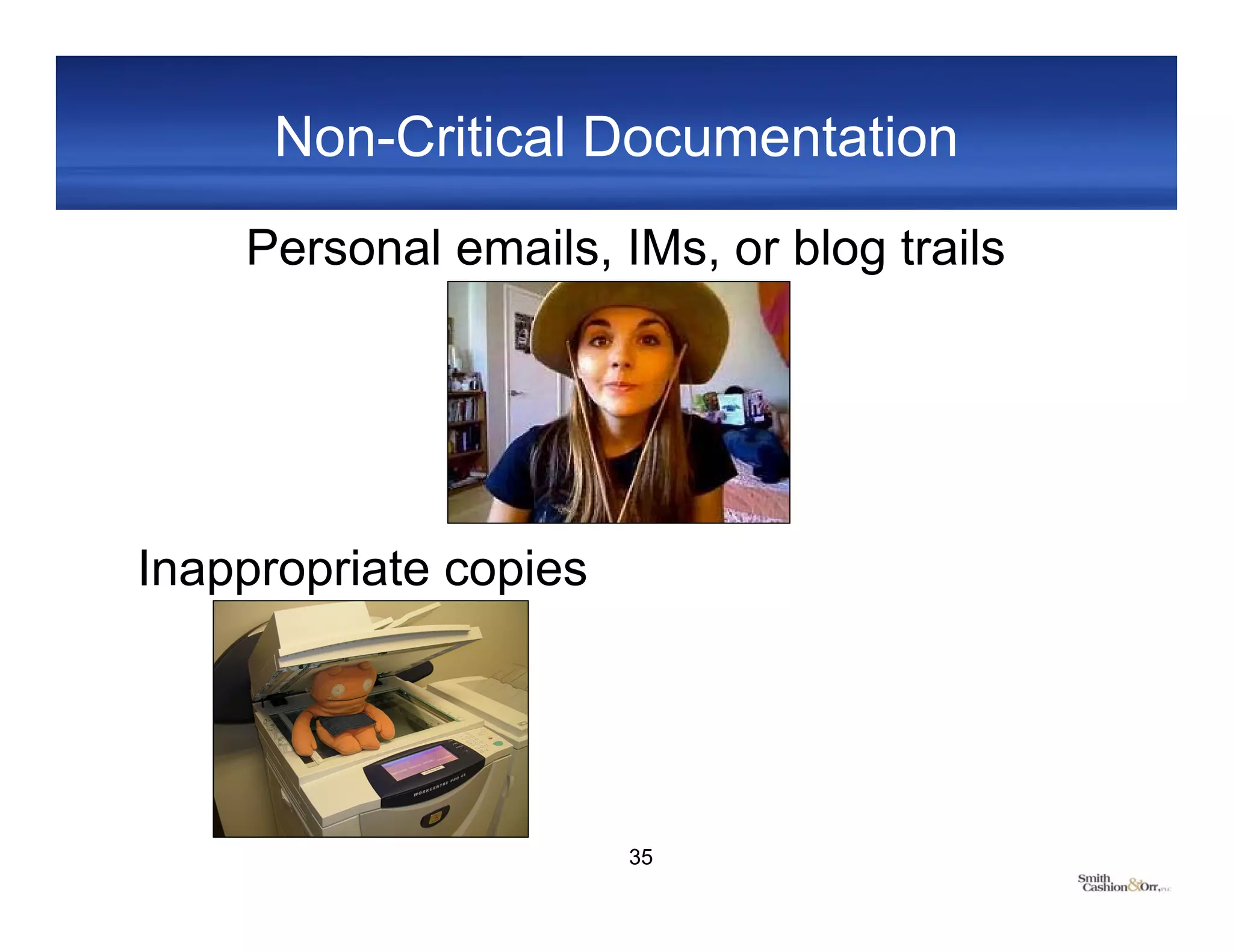

• Why are proper records so essential for
claims and disputes?
(1) To establish causal connection to event
(2) To establish reservation of rights/non-waiver
(3) To properly identify actual costs and delays
25
26. Critical Project Documentation
• Correspondence
– Establish responsibility for responding
to/acting on
– Used to comply with notice requirements
– Used to confirm discussions in writing
• Will help to clarify any misunderstandings
26
27. Critical Project Documentation
• Meeting minutes/notes
– List participants
– Subjects covered
– Nature of discussions
– Future action
– Distribute to all participants or those
affected
– Use previous minutes as agenda for next
meeting
27
28. Critical Project Documentation
• Daily reports/logs
– Routine, contemporaneous description of
work progress and problems
– Create standard form for easier use by
field personnel
– Can be used to build as-built schedule
28
29. Critical Project Documentation
• Daily reports/logs (cont’d)
– Information recorded briefly and concisely
• Manpower by subcontractors
• Equipment used or idle
• Major work activities
• Any delays or problems
• Areas of work not available
• Safety issues and accidents
• Oral instructions and informal meetings
• Weather summary
29
30. Critical Project Documentation
• Personal daily diaries
– Prepared by foreman, superintendents,
project engineers, project managers
• Record site conditions
• Record labor and equipment usage
• Record impediments to work
– Consistency is important
for trustworthiness
30
31. Critical Project Documentation
• Time sheets
– Document manpower
• Number of manhours worked
• Work performed
• Accounting records
– Must prove damages
with reasonable certainty
– Invoices
31
32. Critical Project Documentation
• Photographs
– Monitor, depict and
preserve conditions
– Pictorial diary of project (weekly or monthly)
– Document defective work or problem
conditions
Note pertinent information on back
• Date, time, location, condition depicted,
photographer
• Create photo log
32

33. Critical Project Documentation
• Status/submittal logs
– Shop drawings, field orders, change
requests, change orders, authorizations to
proceed, requests for information, drawing
revisions, transmittals
• CPM schedule
– Realistic baseline
• Input from subs for buy-in
– Regular periodic updates
33
38. Project Management Software
• Different software packages
• Types of information track
• Web based capabilities
• Project management uses
• Executive uses
• Other project team member uses
• Why do we need to know this?
38
39. Software Packages
• Prolog
Manager/Proliance
• Expedition
• Plans and Specs
• Bentley Systems Inc.
• Microsoft Project
– Self hosted
– Application service
provider environment
39
40. Web Based Capabilities
• Project team accesses same
web based database
• Access to design drawings, job
site photos, schedules, and
+400 reports
• Document control is enhanced
by tracking revisions, storing
master files, streamlining review
process
• Compliance with corporate
procedures
40
41. Project Mgt. and Exec. Uses
• Procurement control • Daily reports
• Cost control • Contracts
• Document • Integration with
management SureTrak and
• Field administration Primavera
• Reports • Change orders
• Correspondence • Purchase orders
documents
41
42. Why do we need to know this?
• Step towards paperless project
• Excellent audit trial – check in/out, IP address,
version control
• Consolidate project documentation
• Integration problems with accounting software
42
43. Legal Issues
What is the “put it in writing” rule?
What is hearsay? Non-hearsay? Exceptions?
Email versus Letter versus Change Order?
Can we shred documents at the end?
What about paperless project?
43
44. “Put it in Writing” Rule
• What should you record?
• For whom are you documenting?
– General contractors/subcontractors
– Business/legal purposes
• Hearsay
– What is the hearsay rule?
– Exceptions
44
45. Exceptions to “Hearsay” Rule
– Business record exception
– Author actually observed conditions
– The records were prepared in the normal
course of business
– The records were prepared at the time of
the event(s) or reasonably soon thereafter
– There is no suggestion that the records
were prepared for the specific purpose of
use in litigation –“A less-guarded time.”
45

46. The Paperless Project
• Who owns the license to the program?
• How much access do the parties have to
the documents created in the program?
• Who controls the server?
• Will the parties be granted access to
project documents during the project?
• Is less formal communication (email)
good or bad for the parties?
46
47. Paperless Project (cont’d)
• Would you still use letters?
• Could emails to attorneys be retrieved
by other parties?
• Is a written instruction via email the
same as a change order?
• What type of information would you
want protected?
47

58. The Real World
• “One look is worth a thousand words.”
– Fred Barnard (Dec. 8, 1921 advertisement)
• 畫意能達萬言
– The Home Book of Proverbs, Maxims and Familiar Phrases (Mar. 10, 1927)
• "Un bon croquis vaut mieux qu'un long
discours"
– Napoloean Bonaparte
• “As the Chinese say, 1001 words is worth
more than a picture.”
– John McCarthy, computer scientist
58
59. E-mail: Not-So-Good
To: John
From: Paul
Re: Project Delays
John, I am going to have Drew send you some progress curve comparisons for
us to start the delay status analysis. I think we need to begin the discussion
with our management that we are late and tell them that we are analyzing
how late. We also need to consult the claims team as how we tell our
management that we are late. The schedule needs some serious work to be
used as a float tool and everyone is going to be looking to get answers.
59
60. E-Mail: Bad
From: Contracts Manager about Upper Management
People did not listen and act on previous recommendations in a timely manner
and I am annoyed that those delays significantly impact the cost and schedule
to this project. COMMITMENT from management means listening to the
people who have to make things happen …
Yes, I am annoyed, but more importantly I am concerned where we are going
with this project if people do not listen and act quickly. How can we be
successful with the schedule and cost if we do not have the resources to
execute the job proactively and/or project management does not respond when
we make recommendations? WE NEED HELP!!!!
60

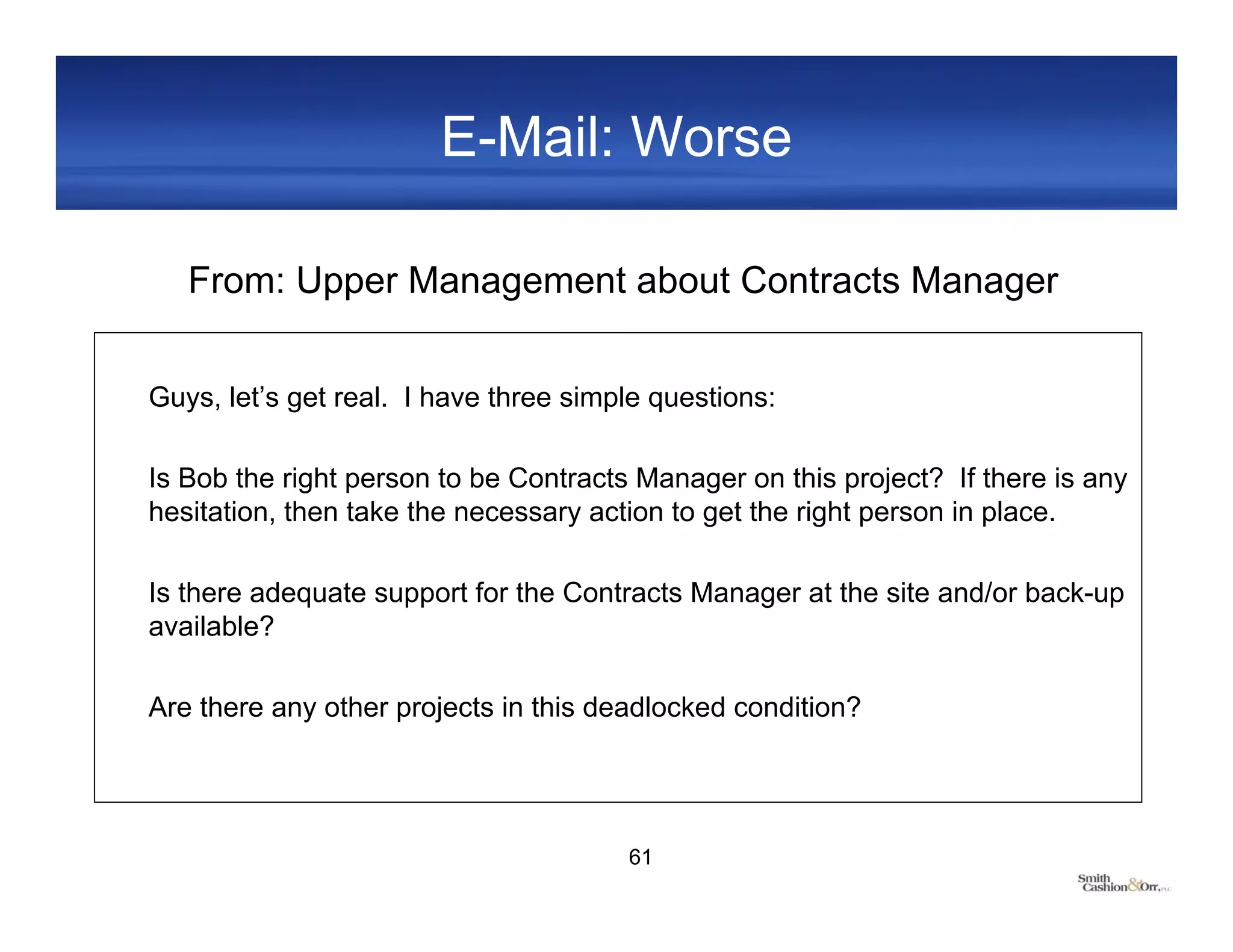

61. E-Mail: Worse
From: Upper Management about Contracts Manager
Guys, let’s get real. I have three simple questions:
Is Bob the right person to be Contracts Manager on this project? If there is any
hesitation, then take the necessary action to get the right person in place.
Is there adequate support for the Contracts Manager at the site and/or back-up
available?
Are there any other projects in this deadlocked condition?
61
62. E-Mail: The Worst
From: Upper Management to Contracts Manager
Bob,
I understand your frustration about lack of support from back in the East. We
are attempting to get the additional resources and assistance that you have
requested. In the meantime, you need to continue with the team in place. If
we are going to make the contractor look like they cannot do their job, we
MUST look and act like we are doing ours!!!
Rob
62

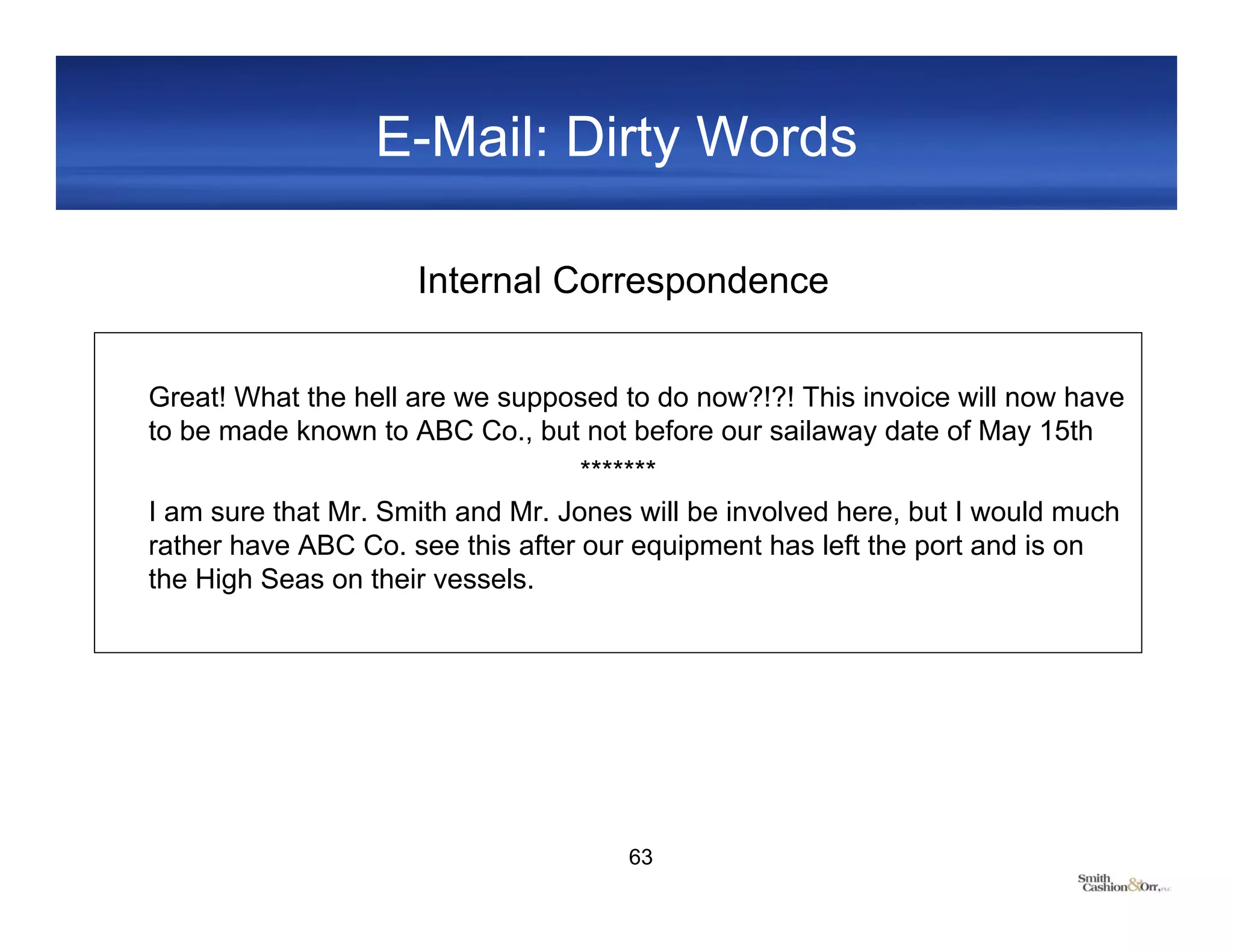

63. E-Mail: Dirty Words
Internal Correspondence
Great! What the hell are we supposed to do now?!?! This invoice will now have
to be made known to ABC Co., but not before our sailaway date of May 15th
*******
I am sure that Mr. Smith and Mr. Jones will be involved here, but I would much
rather have ABC Co. see this after our equipment has left the port and is on
the High Seas on their vessels.
63

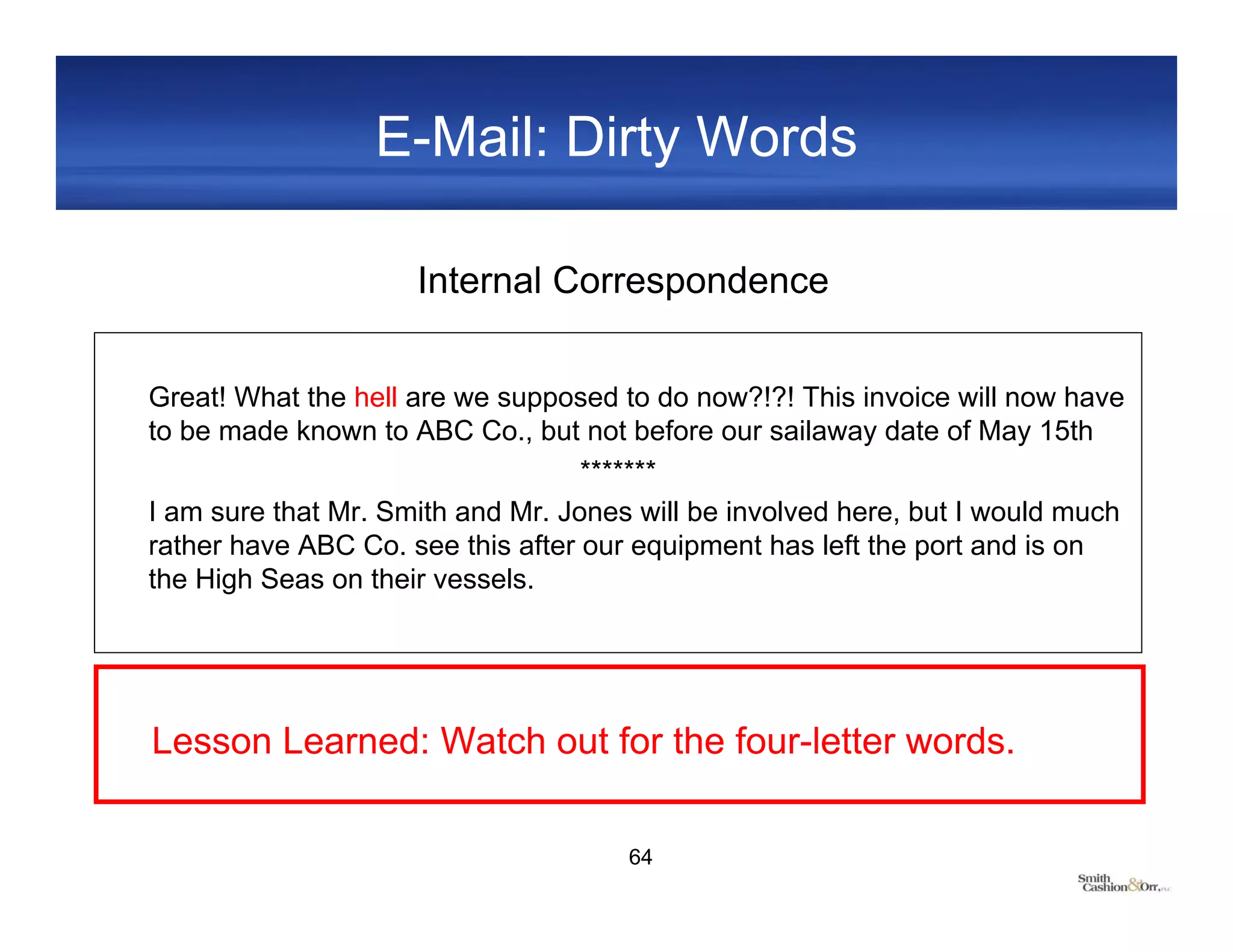

64. E-Mail: Dirty Words
Internal Correspondence
Great! What the hell are we supposed to do now?!?! This invoice will now have
to be made known to ABC Co., but not before our sailaway date of May 15th
*******
I am sure that Mr. Smith and Mr. Jones will be involved here, but I would much
rather have ABC Co. see this after our equipment has left the port and is on
the High Seas on their vessels.
Lesson Learned: Watch out for the four-letter words.
64

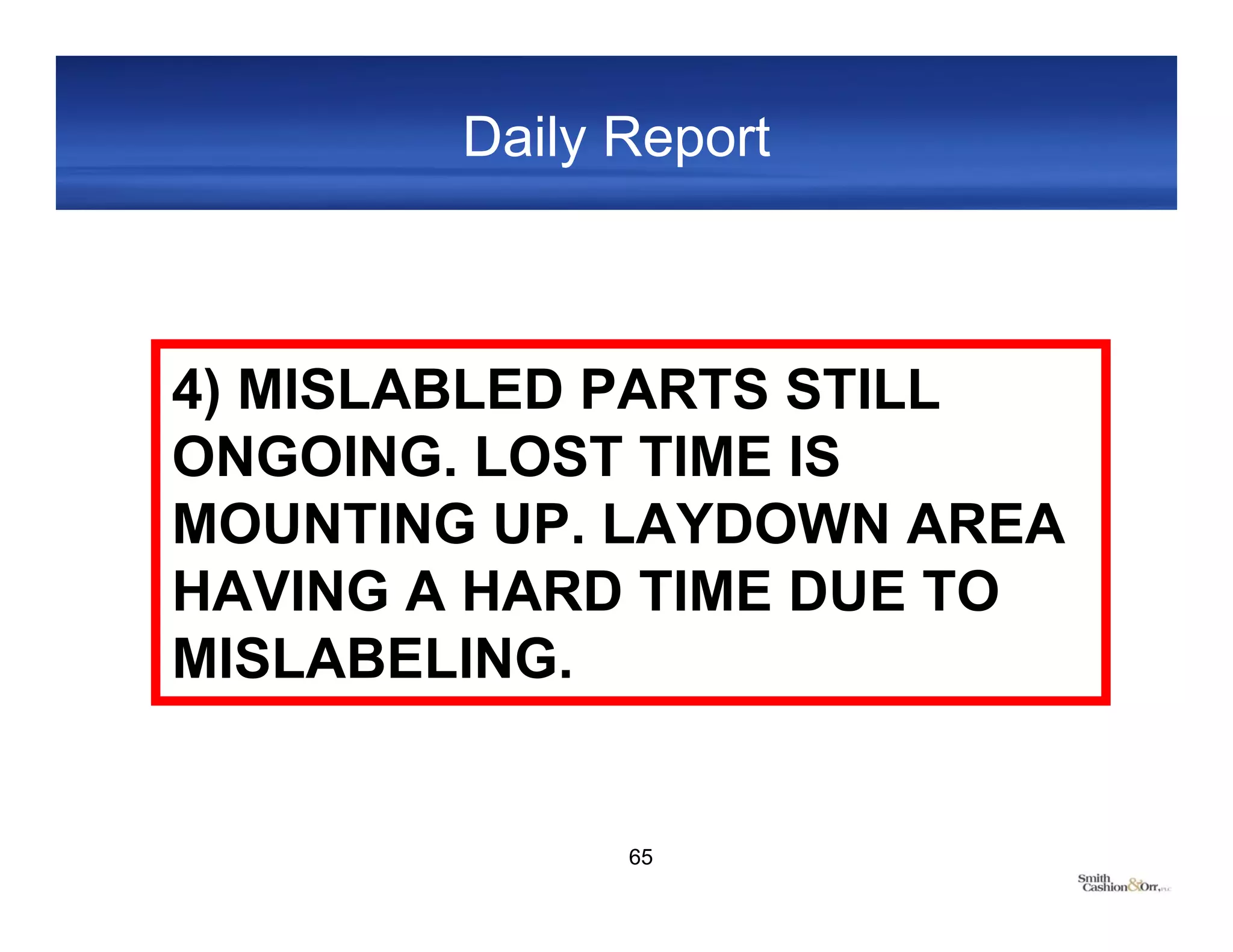

65. Daily Report
4) MISLABLED PARTS STILL
ONGOING. LOST TIME IS
MOUNTING UP. LAYDOWN AREA
HAVING A HARD TIME DUE TO
MISLABELING.
65
69. Photos: Assist in Project Administration
Location:
Nashville, TN
User:
Owner (out‐of‐town)
Feature:
Progression photos used
by project members
during construction
Source: Multivista Construction Documentation
69

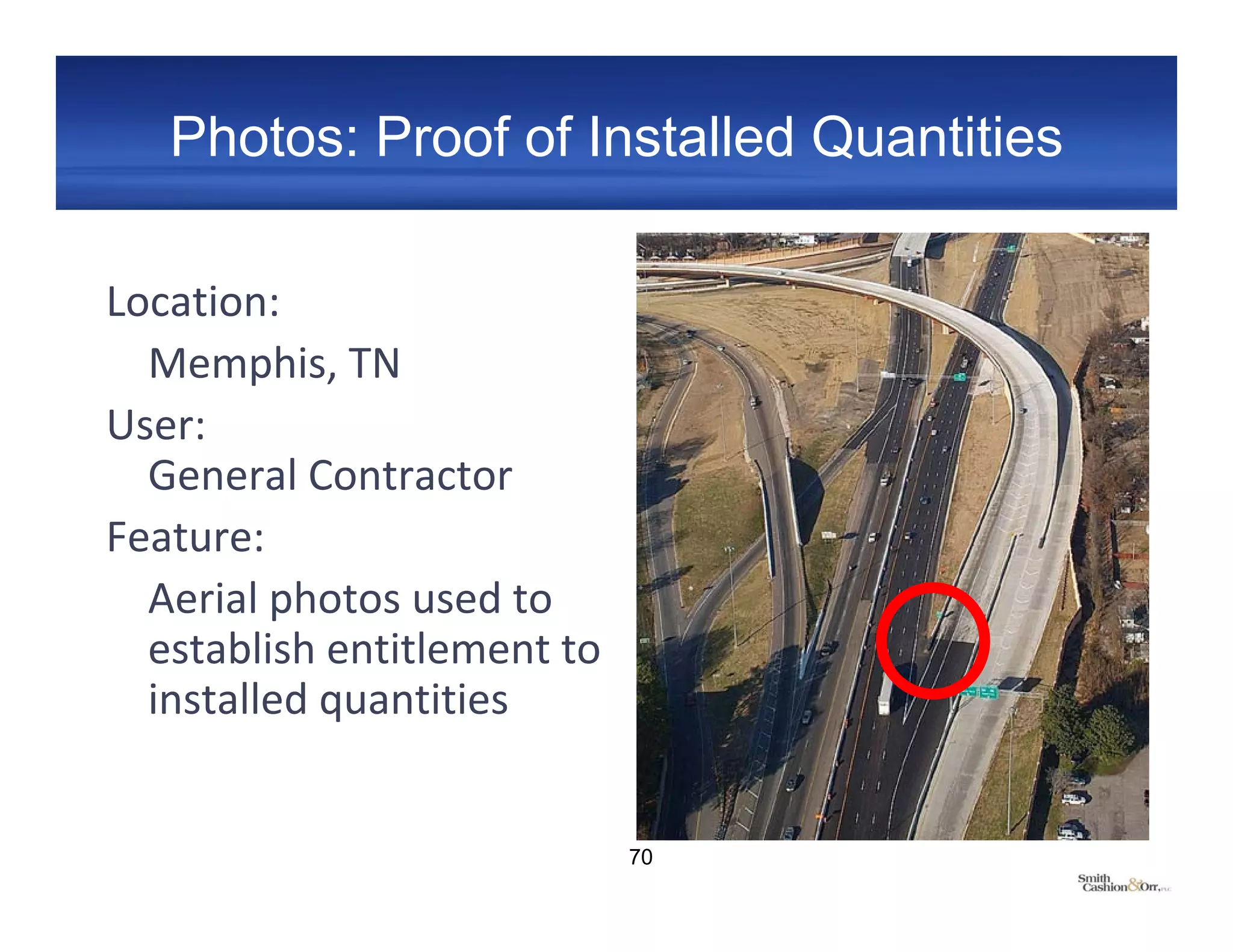

70. Photos: Proof of Installed Quantities
Location:
Memphis, TN
User:
General Contractor
Feature:
Aerial photos used to
establish entitlement to
installed quantities
70

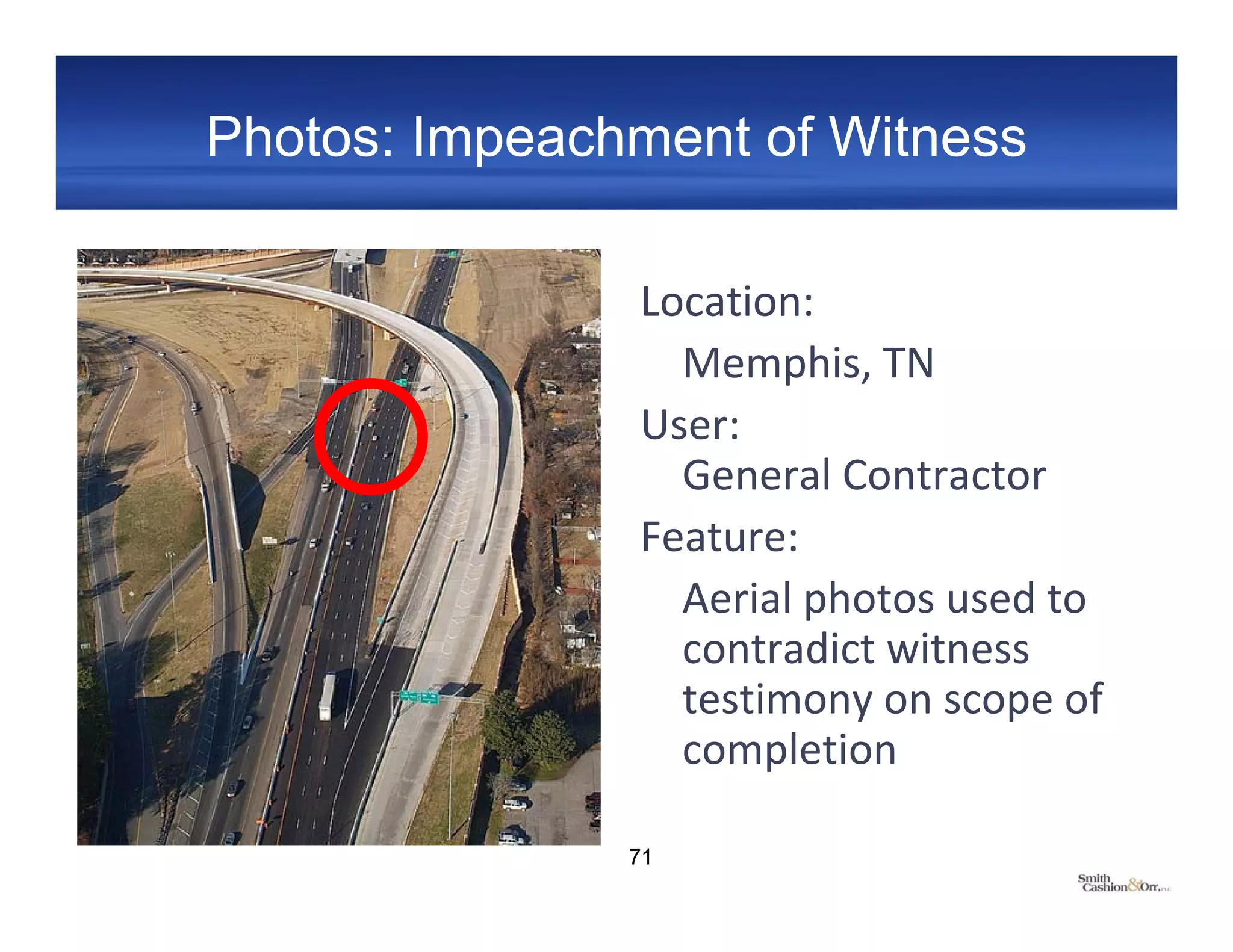

71. Photos: Impeachment of Witness
Location:
Memphis, TN
User:
General Contractor
Feature:
Aerial photos used to
contradict witness
testimony on scope of
completion
71

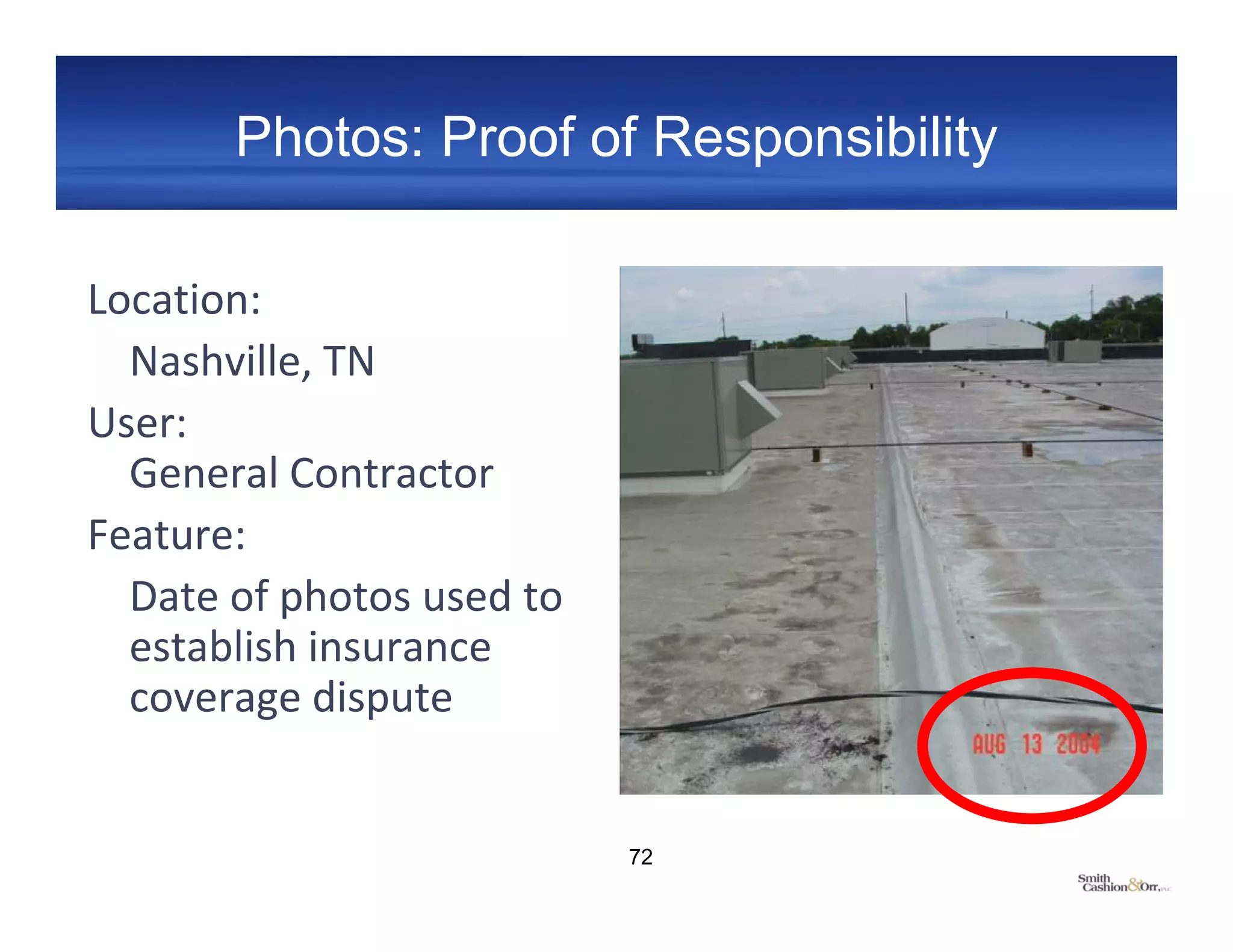

72. Photos: Proof of Responsibility
Location:
Nashville, TN
User:
General Contractor
Feature:
Date of photos used to
establish insurance
coverage dispute
72

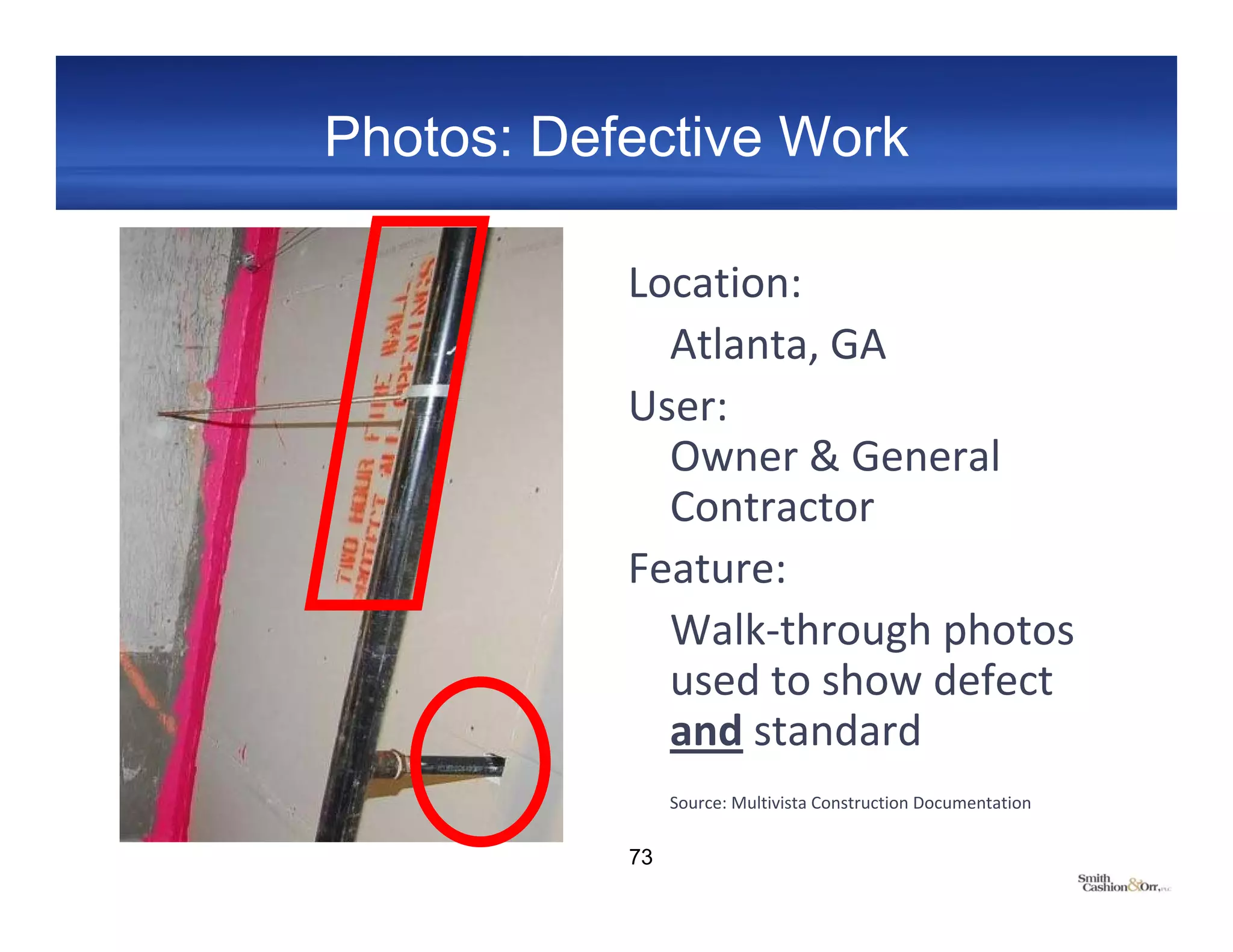

73. Photos: Defective Work
Location:
Atlanta, GA
User:
Owner & General
Contractor
Feature:
Walk‐through photos
used to show defect
and standard
Source: Multivista Construction Documentation
73
74. Photos: Incomplete Work
Location:
Atlanta, GA
User:
General Contractor
Feature:
Interior MEP photos
used to defend claim
by sub for additional $$
Source: Multivista Construction Documentation
74

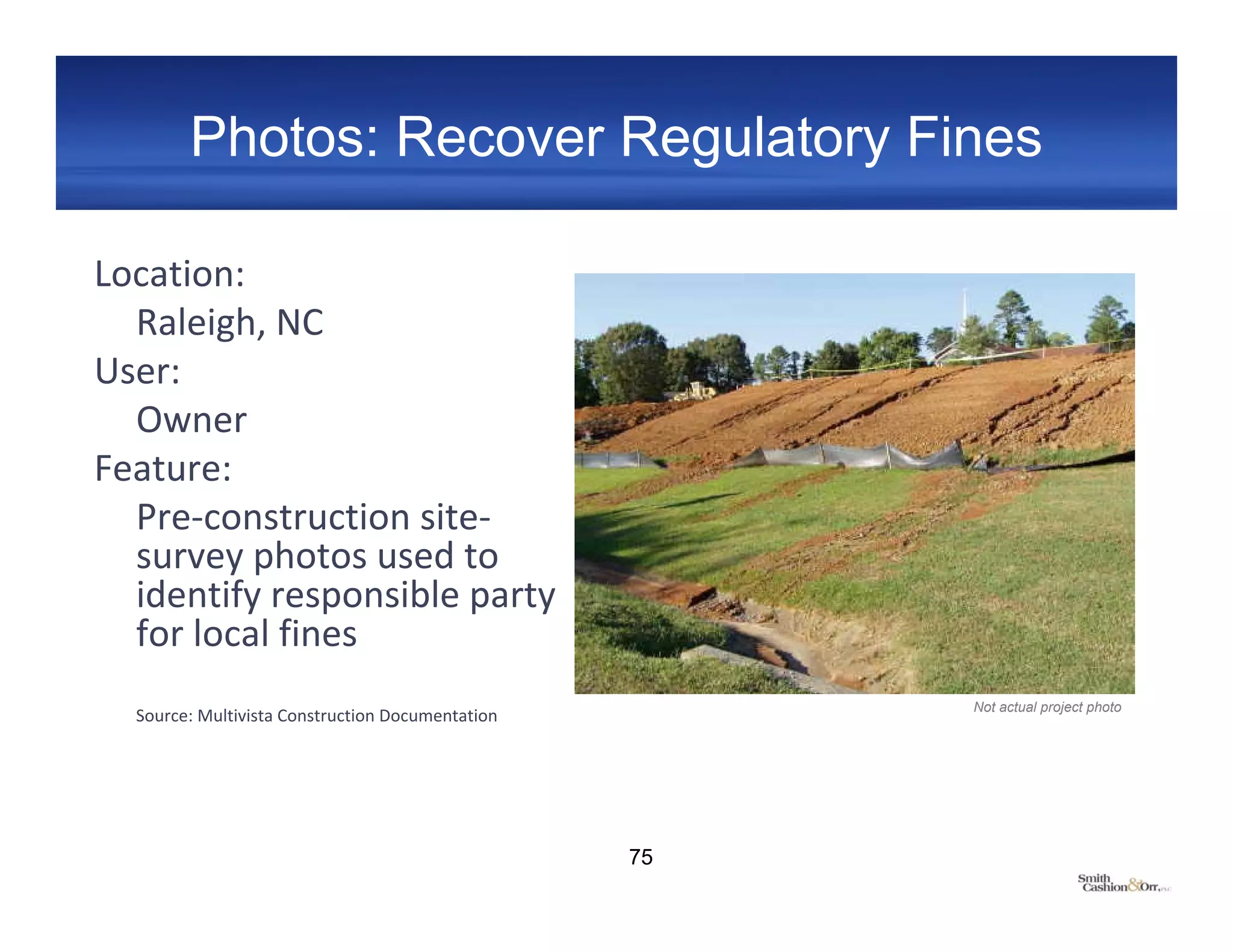

75. Photos: Recover Regulatory Fines
Location:
Raleigh, NC
User:
Owner
Feature:
Pre‐construction site‐
survey photos used to
identify responsible party
for local fines
Not actual project photo
Source: Multivista Construction Documentation
75

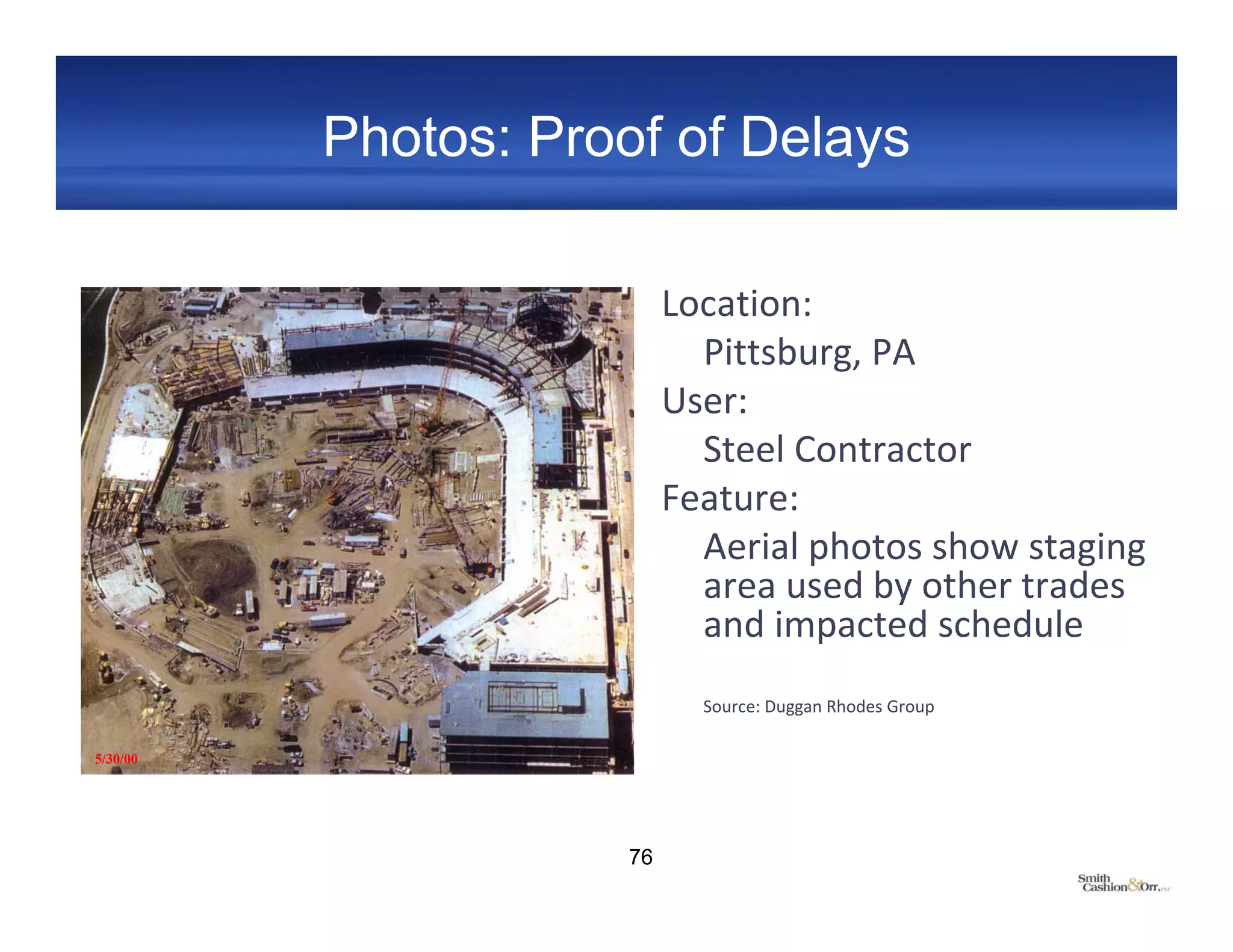

76. Photos: Proof of Delays
Location:
Pittsburg, PA
User:
Steel Contractor
Feature:
Aerial photos show staging
area used by other trades
and impacted schedule
Source: Duggan Rhodes Group
5/30/00
76

78. The Legal World
• Higgins Dev. Partners v. Skanska USA
(Mont. 2009)
– Email sufficient to support a finding of
increased costs for change order
• Inland Construction Co. v. Cameron Park
(N.C. Ct. App. 2007)
– Email promising additional work not a
“contract”
– Lack of executed change order found to be
without merit
78
79. The Legal World
• A-1 General Contracting v. River Market
Communications (N.Y. 1995)
– Handwritten notations on contract “should
be ignored”
– No agreement about payment schedule
• Klein Development v. Ellis K. Phelps & Co.
(Fl. Ct. App. 2000)
– Faxed release of lien binding?
– Letter requesting original signature was
contradictory evidence
79
80. The Legal World
• Bethlehem Area Sch. Dist. v. White Bros.
Construction (Pa. Com. Pl. 2004)
– Letter constituted a limited admission of
damages (tiles and carpet, not mold)
• Raymond’s Building Supply v. Mattson
(Conn. Super. 2007)
– Photographs established that problems
“were or should have been” evident at the
time of termination
80

81. Future Issues
• Green Construction
– LEED ® credit templates, worksheets and
back-up documentation
– Documentation of energy performance
• Social Media 2.0
– Twitter
– LinkedIn
– Facebook
81
82. Questions?
Matt DeVries
Smith Cashion & Orr PLC
231 Third Avenue North
Nashville, TN 37201
(615) 742-8577 direct
(615) 354-3681 cell
mdevries@smithcashion.com
82
83. What to Do When
the Project Goes Bad?
• Review all contracts to determine rights
• Notify the proper persons
• Document the impact
• Reserve rights and proceed under protest
• Prove the monetary loss due to impact
• Negotiate resolution
83
