Advanced Work Packaging
Real Life Implementation
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
About The Speaker
• BE in mechanical engineer with over 17 years of experience in the
construction of mega oil and gas and power plants projects.
• Worked as a piping design engineer in the Engineering division of
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
CCC.
• Worked as a project controls manager (PCM) on projects in KSA,
UAE, Kazakhstan, Bahrain, Qatar, Equatorial Guinea and Oman.
• An expert in project controls and has extensive experience in the
implementation of lean construction and workface planning
• A subject matter expert in piping field engineering.
• Leader of the FIATECH’s PIF project, an initiative to expand ISO
15926 standard to cater for construction requirements.
• Currently working in CCT International on consulting assignments
to implement advanced project control systems.

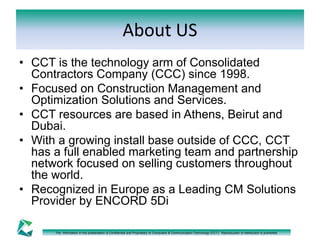

About US
• CCT is the technology arm of Consolidated
Contractors Company (CCC) since 1998.
• Focused on Construction Management and
Optimization Solutions and Services.
• CCT resources are based in Athens, Beirut and
Dubai.
• With a growing install base outside of CCC, CCT
has a full enabled marketing team and partnership
network focused on selling customers throughout
the world.
• Recognized in Europe as a Leading CM Solutions
Provider by ENCORD 5Di
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

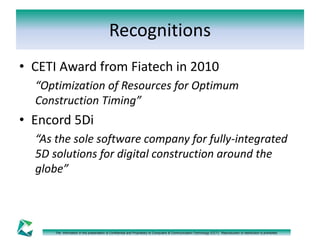

Recognitions
• CETI Award from Fiatech in 2010
“Optimization of Resources for Optimum
Construction Timing”
• Encord 5Di
“As the sole software company for fully-integrated
5D solutions for digital construction around the
globe”
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
It is only natural that EPC sub-optimize
their scope
Project Life Cycle
Unforeseen Cost
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
Car Tuning
Legacy 2D 3D WFP AWP Ultimate
Project
Owner
Project Management
Construction Management
Supply Chaing Management
Engineering
Construction
Operation
Project Over-All Cost
History
• Before 2004
– CPM, Lean
Construction, Last
planner, etc…
2004
2012
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
• 2004
– Workface planning
formalized Did not
Provide Promised
Improvements
• 2012
– Advanced Work
Packaging Introduced to
eliminate bottlenecks
from activities prior to
Installation.
Bottleneck
• Planning
• Design
• Engineering
(EWP)
(CWP)
• Construction
(FIWP)
• Hand over
• Operation
?
Source: COAA – CII May 16, 2012 Presentation by Glen Warren

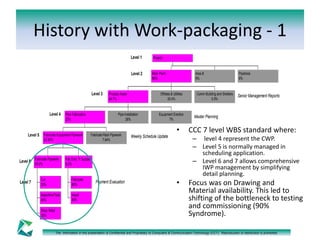

History with Work-packaging - 1
• CCC 7 level WBS standard where:
– level 4 represent the CWP.
– Level 5 is normally managed in
scheduling application.
– Level 6 and 7 allows comprehensive
IWP management by simplifying
detail planning.
• Focus was on Drawing and
Material availability. This led to
shifting of the bottleneck to testing
and commissioning (90%
Syndrome).
Level 1
Fabricate Equipment Pipework
23.83%
Fabricate Pipework
56.2%
Fab Erec. P.Support
8.2%
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
Level 5
Level 6
Level 4
Level 3
Level 2
Payment Evaluation
Weekly Schedule Update
Master Planning
Senior Management Reports
Level 7
Cut
20%
Assemble/Tack
45%
Shop Weld
35%
Fabricate
60%
Install
40%
Fabricate Rack Pipework
7.64%
Pipe Fabrication
23%
Pipe Installation
26%
Equipment Erection
7%
Process Areas
44.7%
Offsites & Utilities
20.4%
Comm Building and Shelters
5.9%
Main Plant
86%
Area B
6%
Pipelines
8%
Project

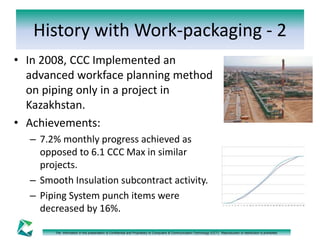

History with Work-packaging - 2
• In 2008, CCC Implemented an
advanced workface planning method
on piping only in a project in
Kazakhstan.
• Achievements:
– 7.2% monthly progress achieved as
opposed to 6.1 CCC Max in similar
projects.
– Smooth Insulation subcontract activity.
– Piping System punch items were
decreased by 16%.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
History with Work-packaging - 3
• In 2010, CCC improved the
process by adding all
disciplines starting by
underground packages with
the introduction of FEL in UAE:
• Achievements:
– started paving activity 3 months
ahead of schedule.
– Piping site welding achieved
30% improvement.
– 60% reduction in punch list
numbers.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

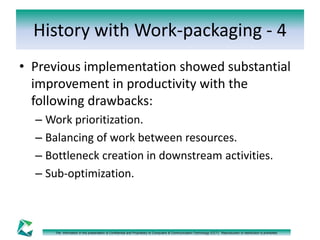

History with Work-packaging - 4
• Previous implementation showed substantial
improvement in productivity with the
following drawbacks:
– Work prioritization.
– Balancing of work between resources.
– Bottleneck creation in downstream activities.
– Sub-optimization.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

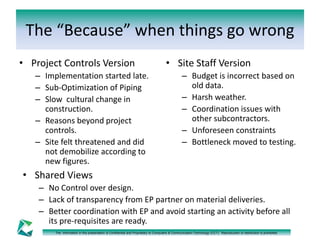

The “Because” when things go wrong
• Project Controls Version
– Implementation started late.
– Sub-Optimization of Piping
– Slow cultural change in
construction.
– Reasons beyond project
controls.
– Site felt threatened and did
not demobilize according to
new figures.
• Site Staff Version
– Budget is incorrect based on
old data.
– Harsh weather.
– Coordination issues with
other subcontractors.
– Unforeseen constraints
– Bottleneck moved to testing.
• Shared Views
– No Control over design.
– Lack of transparency from EP partner on material deliveries.
– Better coordination with EP and avoid starting an activity before all
its pre-requisites are ready.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
Ongoing Implementation
• Project Status at the start of implementation.
• Challenges
• Mitigation
• Rooms for improvement
• Epilogue
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

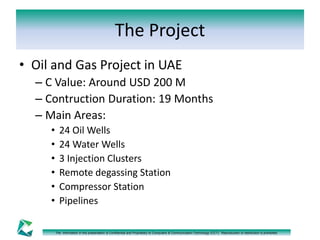

The Project
• Oil and Gas Project in UAE
– C Value: Around USD 200 M
– Contruction Duration: 19 Months
– Main Areas:
• 24 Oil Wells
• 24 Water Wells
• 3 Injection Clusters
• Remote degassing Station
• Compressor Station
• Pipelines
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

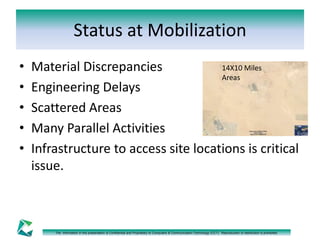

Status at Mobilization
• Material Discrepancies
14X10 Miles
Areas
• Engineering Delays
• Scattered Areas
• Many Parallel Activities
• Infrastructure to access site locations is critical
issue.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

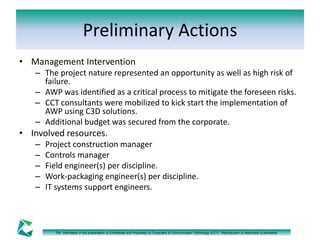

Preliminary Actions
• Management Intervention
– The project nature represented an opportunity as well as high risk of
failure.
– AWP was identified as a critical process to mitigate the foreseen risks.
– CCT consultants were mobilized to kick start the implementation of
AWP using C3D solutions.
– Additional budget was secured from the corporate.
• Involved resources.
– Project construction manager
– Controls manager
– Field engineer(s) per discipline.
– Work-packaging engineer(s) per discipline.
– IT systems support engineers.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

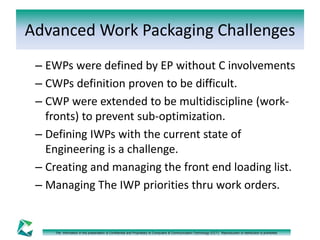

Advanced Work Packaging Challenges
– EWPs were defined by EP without C involvements
– CWPs definition proven to be difficult.
– CWP were extended to be multidiscipline (work-fronts)
to prevent sub-optimization.
– Defining IWPs with the current state of
Engineering is a challenge.
– Creating and managing the front end loading list.
– Managing The IWP priorities thru work orders.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

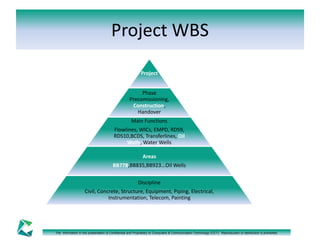

Project WBS
Project
Phase
Precomissioning,
Construction,
Handover
Main Functions
Flowlines, WICs, EMPD, RDS9,
RDS10,BCDS, Transferlines, Oil
Wells, Water Wells
Areas
BB778,BB835,BB923...Oil Wells
Discipline
Civil, Concrete, Structure, Equipment, Piping, Electrical,
Instrumentation, Telecom, Painting
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

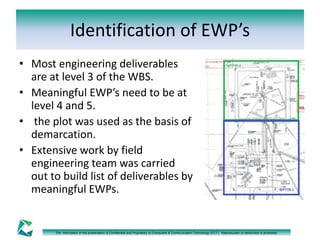

Identification of EWP’s
• Most engineering deliverables
are at level 3 of the WBS.
• Meaningful EWP’s need to be at
level 4 and 5.
• the plot was used as the basis of
demarcation.
• Extensive work by field
engineering team was carried
out to build list of deliverables by
meaningful EWPs.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
Propagation Into CWP’s
• With many repeatable areas the
BOQ detailing was left at level 3
of the WBS.
• 3D Models used to detail the
BOQ when possible.
• Estimate Data complemented
the Detail providing resource
requirements per CWP.
• CWP requirements definition
depended largely on CM
experience.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
IWP Creation - 1
• At Start
– Model Complete
• Has Piping and Equipment tags
• Structural, electrical and civil are not
tagged.
• Only pipe support foundation had tags.
• Piping have different datum than rest
of the model
– Construction Drawings Status
• Piping material code need mapping to
delivered material.
• Civil drawings lacked tagging.
• Electrical sables were tagged.
• Structural drawing had tags but were
late.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
IWP Creation - 2
• Preparation Activities
– Civil drawings were tagged
manually and their tags were added
into 3D models.
– Electrical trenches and trays were
tagged with the corresponding
routing detail.
– Piping material was changed based
on material dictionary, Translated
and uploaded to 3D Models using
Solinas.
– Structural steel models were
grouped by bay and tagged
accordingly.
Civil Tagging In C3D
Piping Drawing from Solinas
Structural Tagging
by Bay With C3D
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
IWP Creation - 3
• Preparation Activities
– The site material system (Talisman) was
populated with all the tags and
maintained.
– Project schedule was expanded 2 more
levels to contain the tags and the
corresponding operations.
– Corresponding BOQs linked to Tags
– Budget cost codes linked to operation
level.
– Safety training status was linked to IWPs.
– All Coordination meeting actions were
linked to IWPs.
Last Level Template
in Talisman
BOQ attachment
with C3D Interactive
C3D OBS linked to
HR for safety record
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

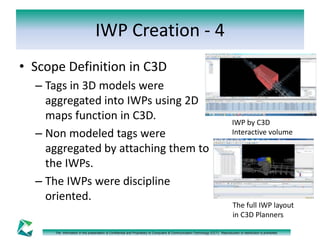

IWP Creation - 4
• Scope Definition in C3D
– Tags in 3D models were
aggregated into IWPs using 2D
maps function in C3D.
– Non modeled tags were
aggregated by attaching them to
the IWPs.
– The IWPs were discipline
oriented.
IWP by C3D
Interactive volume
The full IWP layout
in C3D Planners
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

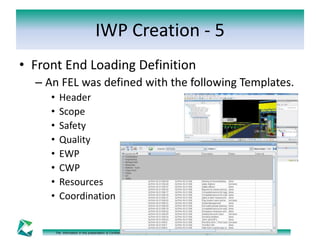

IWP Creation - 5
• Front End Loading Definition
– An FEL was defined with the following Templates.
• Header
• Scope
• Safety
• Quality
• EWP
• CWP
• Resources
• Coordination
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
IWP Implementation - 1
• FELs were added to the 3D site planning
Application (C3D Planner).
• Every IWP Template type was linked to its
relevant records in various control
applications.
– Scope to Talisman complemented with 3D.
– Safety to HRMS and VBC
– Quality to Atlas handover system.
– Machinery resources to fleet management
system
– Craftsmen actual working hours to Time
Sheet System.
– Material Resources to Talisman.
Actions
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
2D
Maps
3D
WBS
Time
Sheet
Machinery
Shop
Drawing
VBC
IWP Implementation - 2
• Management steps of IWPs.
1. Relations between various
IWPs created.
2. Build relations between
Tags and P6, IWPs required
start and finish dates were
established.
3. Build relations between
budget and tags – required
resources established/IWP.
4. Issuance and follow-up of
IWPs is carried using C3D
planner.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
IWP Workflow
IWP Issued
P6 Dictate
Start and End
Time
Budget Defines
planned
Resources
FEL Ensure no
Constraints
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
System Gets
Updated
Work Is
Carried
• Such workflow normally
entails usage of many
software applications.
• It is extremely important
to have all of these
applications integrated.
• Having one application
taking care of all steps is a
key challenge.
• The next slide shows the
applications used to
execute this workflow
List of Applications Used by CCC
Activity Application Used
Civil Drawing Tagging and Logging Pencil and Talisman
3D Model Tagging All Discipline C3D Interactive
Piping Material Change, Translate, 3D Solinas
Structural Steel Grouping C3D Interactive
Project ERP Talisman
Project Schedule up to Activity Primavera P6
Project Schedule Tag and Operation C3D Planner
BOQ to Tag Attachment C3D Interactive
Budget to BOQ Attachment C3D Interactive
Safety Training Logging HRMS
Coordination MOM VBC
FEL Management and 3D Linking C3D Interactive
Quality and Handover System Atlas
Resource Management TimeSheet and Maximo
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
In a perfect world
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
• IF
– EWP were in line with Construction WBS
– No Material discrepancies existed
– Engineering Delays were shared with contractor.
• Then
– Many manual data entry and accompanied human
errors would be avoided.
– Contractor would have 3 to 6 months early
identification of bottlenecks
– Schedule would have been updated to mitigate
engineering delays.
Practical Approach to Create IWPs
• CCC relies on C3D system to achieve the following
objectives:
– Easy WBS re-organization.
– Reflect shop drawings information in 3D model.
– Rule Based Packaging.
– Establish integration with various applications (P6, VBC, Atlas,
Talisman, HRMS …).
– Fast addition of Site information and tags into the 3D model.
– Leverage C3D flexible creation of hierarchies to manage IWPs by
System/Sub-system rather than by WBS.
– View all workpackage information in one portal.
– Flexible detail planning and progress measurement for both
modeled and non modeled objects.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
Key Challenges
• Having construction teams buy into the process.
• Convince management on the benefits of AWP
approach.
• Cultural changes to align controls and site points of
views.
• KPI mechanism to measure performance
improvements in numbers, how to show ROI?
• Secure Hybrid team formation:
– To accelerate the IWPs creation.
– To properly communicate the information to site.
– Initially mobilize a specialized team to expedite the
creation of IWPs.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
Epilogue - 1
• There are practical challenges in building
IWPs.
– Information silos.
– Scope and requirements
– Data Gathering.
– Data Interoperability.
– Lack of easy tools and in most cases multiple tools
are required.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
Epilogue - 2
• ROI needs more marketing (internal .
• More successful case studies highlighting real
improvements need to be shared globally .
• It is highly recommended that owners come
on board because:
– Project Cost is not only EPC.
– O and M is a big part of the cost.
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
Videos If Time Permits
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
• Plan
– Work Packaging
– Assignment of Work Order
– Available Piping work
– Steel Delivery Effect
– How steel was received and built.
– Spool fabrication Sequence effect on erection
• Hand Over and Quality
– Digital Pen Integration
– QC Progress Report
– Punch List tracking
– Raising Inspection Request
THANK YOU
The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.

Advanced Work Packaging - Real Life Implementation

  • 1.
    Advanced Work Packaging Real Life Implementation The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 2.
    About The Speaker • BE in mechanical engineer with over 17 years of experience in the construction of mega oil and gas and power plants projects. • Worked as a piping design engineer in the Engineering division of The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited. CCC. • Worked as a project controls manager (PCM) on projects in KSA, UAE, Kazakhstan, Bahrain, Qatar, Equatorial Guinea and Oman. • An expert in project controls and has extensive experience in the implementation of lean construction and workface planning • A subject matter expert in piping field engineering. • Leader of the FIATECH’s PIF project, an initiative to expand ISO 15926 standard to cater for construction requirements. • Currently working in CCT International on consulting assignments to implement advanced project control systems.
  • 3.
    About US •CCT is the technology arm of Consolidated Contractors Company (CCC) since 1998. • Focused on Construction Management and Optimization Solutions and Services. • CCT resources are based in Athens, Beirut and Dubai. • With a growing install base outside of CCC, CCT has a full enabled marketing team and partnership network focused on selling customers throughout the world. • Recognized in Europe as a Leading CM Solutions Provider by ENCORD 5Di The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 4.
    Recognitions • CETIAward from Fiatech in 2010 “Optimization of Resources for Optimum Construction Timing” • Encord 5Di “As the sole software company for fully-integrated 5D solutions for digital construction around the globe” The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 5.
    It is onlynatural that EPC sub-optimize their scope Project Life Cycle Unforeseen Cost The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited. Car Tuning Legacy 2D 3D WFP AWP Ultimate Project Owner Project Management Construction Management Supply Chaing Management Engineering Construction Operation Project Over-All Cost
  • 6.
    History • Before2004 – CPM, Lean Construction, Last planner, etc… 2004 2012 The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited. • 2004 – Workface planning formalized Did not Provide Promised Improvements • 2012 – Advanced Work Packaging Introduced to eliminate bottlenecks from activities prior to Installation. Bottleneck • Planning • Design • Engineering (EWP) (CWP) • Construction (FIWP) • Hand over • Operation ? Source: COAA – CII May 16, 2012 Presentation by Glen Warren
  • 7.
    History with Work-packaging- 1 • CCC 7 level WBS standard where: – level 4 represent the CWP. – Level 5 is normally managed in scheduling application. – Level 6 and 7 allows comprehensive IWP management by simplifying detail planning. • Focus was on Drawing and Material availability. This led to shifting of the bottleneck to testing and commissioning (90% Syndrome). Level 1 Fabricate Equipment Pipework 23.83% Fabricate Pipework 56.2% Fab Erec. P.Support 8.2% The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited. Level 5 Level 6 Level 4 Level 3 Level 2 Payment Evaluation Weekly Schedule Update Master Planning Senior Management Reports Level 7 Cut 20% Assemble/Tack 45% Shop Weld 35% Fabricate 60% Install 40% Fabricate Rack Pipework 7.64% Pipe Fabrication 23% Pipe Installation 26% Equipment Erection 7% Process Areas 44.7% Offsites & Utilities 20.4% Comm Building and Shelters 5.9% Main Plant 86% Area B 6% Pipelines 8% Project
  • 8.
    History with Work-packaging- 2 • In 2008, CCC Implemented an advanced workface planning method on piping only in a project in Kazakhstan. • Achievements: – 7.2% monthly progress achieved as opposed to 6.1 CCC Max in similar projects. – Smooth Insulation subcontract activity. – Piping System punch items were decreased by 16%. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 9.
    History with Work-packaging- 3 • In 2010, CCC improved the process by adding all disciplines starting by underground packages with the introduction of FEL in UAE: • Achievements: – started paving activity 3 months ahead of schedule. – Piping site welding achieved 30% improvement. – 60% reduction in punch list numbers. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 10.
    History with Work-packaging- 4 • Previous implementation showed substantial improvement in productivity with the following drawbacks: – Work prioritization. – Balancing of work between resources. – Bottleneck creation in downstream activities. – Sub-optimization. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 11.
    The “Because” whenthings go wrong • Project Controls Version – Implementation started late. – Sub-Optimization of Piping – Slow cultural change in construction. – Reasons beyond project controls. – Site felt threatened and did not demobilize according to new figures. • Site Staff Version – Budget is incorrect based on old data. – Harsh weather. – Coordination issues with other subcontractors. – Unforeseen constraints – Bottleneck moved to testing. • Shared Views – No Control over design. – Lack of transparency from EP partner on material deliveries. – Better coordination with EP and avoid starting an activity before all its pre-requisites are ready. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 12.
    Ongoing Implementation •Project Status at the start of implementation. • Challenges • Mitigation • Rooms for improvement • Epilogue The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 13.
    The Project •Oil and Gas Project in UAE – C Value: Around USD 200 M – Contruction Duration: 19 Months – Main Areas: • 24 Oil Wells • 24 Water Wells • 3 Injection Clusters • Remote degassing Station • Compressor Station • Pipelines The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 14.
    Status at Mobilization • Material Discrepancies 14X10 Miles Areas • Engineering Delays • Scattered Areas • Many Parallel Activities • Infrastructure to access site locations is critical issue. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 15.
    Preliminary Actions •Management Intervention – The project nature represented an opportunity as well as high risk of failure. – AWP was identified as a critical process to mitigate the foreseen risks. – CCT consultants were mobilized to kick start the implementation of AWP using C3D solutions. – Additional budget was secured from the corporate. • Involved resources. – Project construction manager – Controls manager – Field engineer(s) per discipline. – Work-packaging engineer(s) per discipline. – IT systems support engineers. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 16.
    Advanced Work PackagingChallenges – EWPs were defined by EP without C involvements – CWPs definition proven to be difficult. – CWP were extended to be multidiscipline (work-fronts) to prevent sub-optimization. – Defining IWPs with the current state of Engineering is a challenge. – Creating and managing the front end loading list. – Managing The IWP priorities thru work orders. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 17.
    Project WBS Project Phase Precomissioning, Construction, Handover Main Functions Flowlines, WICs, EMPD, RDS9, RDS10,BCDS, Transferlines, Oil Wells, Water Wells Areas BB778,BB835,BB923...Oil Wells Discipline Civil, Concrete, Structure, Equipment, Piping, Electrical, Instrumentation, Telecom, Painting The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 18.
    Identification of EWP’s • Most engineering deliverables are at level 3 of the WBS. • Meaningful EWP’s need to be at level 4 and 5. • the plot was used as the basis of demarcation. • Extensive work by field engineering team was carried out to build list of deliverables by meaningful EWPs. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 19.
    Propagation Into CWP’s • With many repeatable areas the BOQ detailing was left at level 3 of the WBS. • 3D Models used to detail the BOQ when possible. • Estimate Data complemented the Detail providing resource requirements per CWP. • CWP requirements definition depended largely on CM experience. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 20.
    IWP Creation -1 • At Start – Model Complete • Has Piping and Equipment tags • Structural, electrical and civil are not tagged. • Only pipe support foundation had tags. • Piping have different datum than rest of the model – Construction Drawings Status • Piping material code need mapping to delivered material. • Civil drawings lacked tagging. • Electrical sables were tagged. • Structural drawing had tags but were late. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 21.
    IWP Creation -2 • Preparation Activities – Civil drawings were tagged manually and their tags were added into 3D models. – Electrical trenches and trays were tagged with the corresponding routing detail. – Piping material was changed based on material dictionary, Translated and uploaded to 3D Models using Solinas. – Structural steel models were grouped by bay and tagged accordingly. Civil Tagging In C3D Piping Drawing from Solinas Structural Tagging by Bay With C3D The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 22.
    IWP Creation -3 • Preparation Activities – The site material system (Talisman) was populated with all the tags and maintained. – Project schedule was expanded 2 more levels to contain the tags and the corresponding operations. – Corresponding BOQs linked to Tags – Budget cost codes linked to operation level. – Safety training status was linked to IWPs. – All Coordination meeting actions were linked to IWPs. Last Level Template in Talisman BOQ attachment with C3D Interactive C3D OBS linked to HR for safety record The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 23.
    IWP Creation -4 • Scope Definition in C3D – Tags in 3D models were aggregated into IWPs using 2D maps function in C3D. – Non modeled tags were aggregated by attaching them to the IWPs. – The IWPs were discipline oriented. IWP by C3D Interactive volume The full IWP layout in C3D Planners The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 24.
    IWP Creation -5 • Front End Loading Definition – An FEL was defined with the following Templates. • Header • Scope • Safety • Quality • EWP • CWP • Resources • Coordination The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 25.
    IWP Implementation -1 • FELs were added to the 3D site planning Application (C3D Planner). • Every IWP Template type was linked to its relevant records in various control applications. – Scope to Talisman complemented with 3D. – Safety to HRMS and VBC – Quality to Atlas handover system. – Machinery resources to fleet management system – Craftsmen actual working hours to Time Sheet System. – Material Resources to Talisman. Actions The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited. 2D Maps 3D WBS Time Sheet Machinery Shop Drawing VBC
  • 26.
    IWP Implementation -2 • Management steps of IWPs. 1. Relations between various IWPs created. 2. Build relations between Tags and P6, IWPs required start and finish dates were established. 3. Build relations between budget and tags – required resources established/IWP. 4. Issuance and follow-up of IWPs is carried using C3D planner. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 27.
    IWP Workflow IWPIssued P6 Dictate Start and End Time Budget Defines planned Resources FEL Ensure no Constraints The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited. System Gets Updated Work Is Carried • Such workflow normally entails usage of many software applications. • It is extremely important to have all of these applications integrated. • Having one application taking care of all steps is a key challenge. • The next slide shows the applications used to execute this workflow
  • 28.
    List of ApplicationsUsed by CCC Activity Application Used Civil Drawing Tagging and Logging Pencil and Talisman 3D Model Tagging All Discipline C3D Interactive Piping Material Change, Translate, 3D Solinas Structural Steel Grouping C3D Interactive Project ERP Talisman Project Schedule up to Activity Primavera P6 Project Schedule Tag and Operation C3D Planner BOQ to Tag Attachment C3D Interactive Budget to BOQ Attachment C3D Interactive Safety Training Logging HRMS Coordination MOM VBC FEL Management and 3D Linking C3D Interactive Quality and Handover System Atlas Resource Management TimeSheet and Maximo The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 29.
    In a perfectworld The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited. • IF – EWP were in line with Construction WBS – No Material discrepancies existed – Engineering Delays were shared with contractor. • Then – Many manual data entry and accompanied human errors would be avoided. – Contractor would have 3 to 6 months early identification of bottlenecks – Schedule would have been updated to mitigate engineering delays.
  • 30.
    Practical Approach toCreate IWPs • CCC relies on C3D system to achieve the following objectives: – Easy WBS re-organization. – Reflect shop drawings information in 3D model. – Rule Based Packaging. – Establish integration with various applications (P6, VBC, Atlas, Talisman, HRMS …). – Fast addition of Site information and tags into the 3D model. – Leverage C3D flexible creation of hierarchies to manage IWPs by System/Sub-system rather than by WBS. – View all workpackage information in one portal. – Flexible detail planning and progress measurement for both modeled and non modeled objects. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 31.
    Key Challenges •Having construction teams buy into the process. • Convince management on the benefits of AWP approach. • Cultural changes to align controls and site points of views. • KPI mechanism to measure performance improvements in numbers, how to show ROI? • Secure Hybrid team formation: – To accelerate the IWPs creation. – To properly communicate the information to site. – Initially mobilize a specialized team to expedite the creation of IWPs. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 32.
    Epilogue - 1 • There are practical challenges in building IWPs. – Information silos. – Scope and requirements – Data Gathering. – Data Interoperability. – Lack of easy tools and in most cases multiple tools are required. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 33.
    Epilogue - 2 • ROI needs more marketing (internal . • More successful case studies highlighting real improvements need to be shared globally . • It is highly recommended that owners come on board because: – Project Cost is not only EPC. – O and M is a big part of the cost. The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
  • 34.
    Videos If TimePermits The information in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited. • Plan – Work Packaging – Assignment of Work Order – Available Piping work – Steel Delivery Effect – How steel was received and built. – Spool fabrication Sequence effect on erection • Hand Over and Quality – Digital Pen Integration – QC Progress Report – Punch List tracking – Raising Inspection Request
  • 35.
    THANK YOU Theinformation in this presentation is Confidential and Proprietary to Computers & Communication Technology (CCT). Reproduction or distribution is prohibited.
