SlideShare a Scribd company logo
‫الزمنية‬ ‫والبرامج‬ ‫التخطيط‬ ‫إدارة‬
Project Schedule Management
2

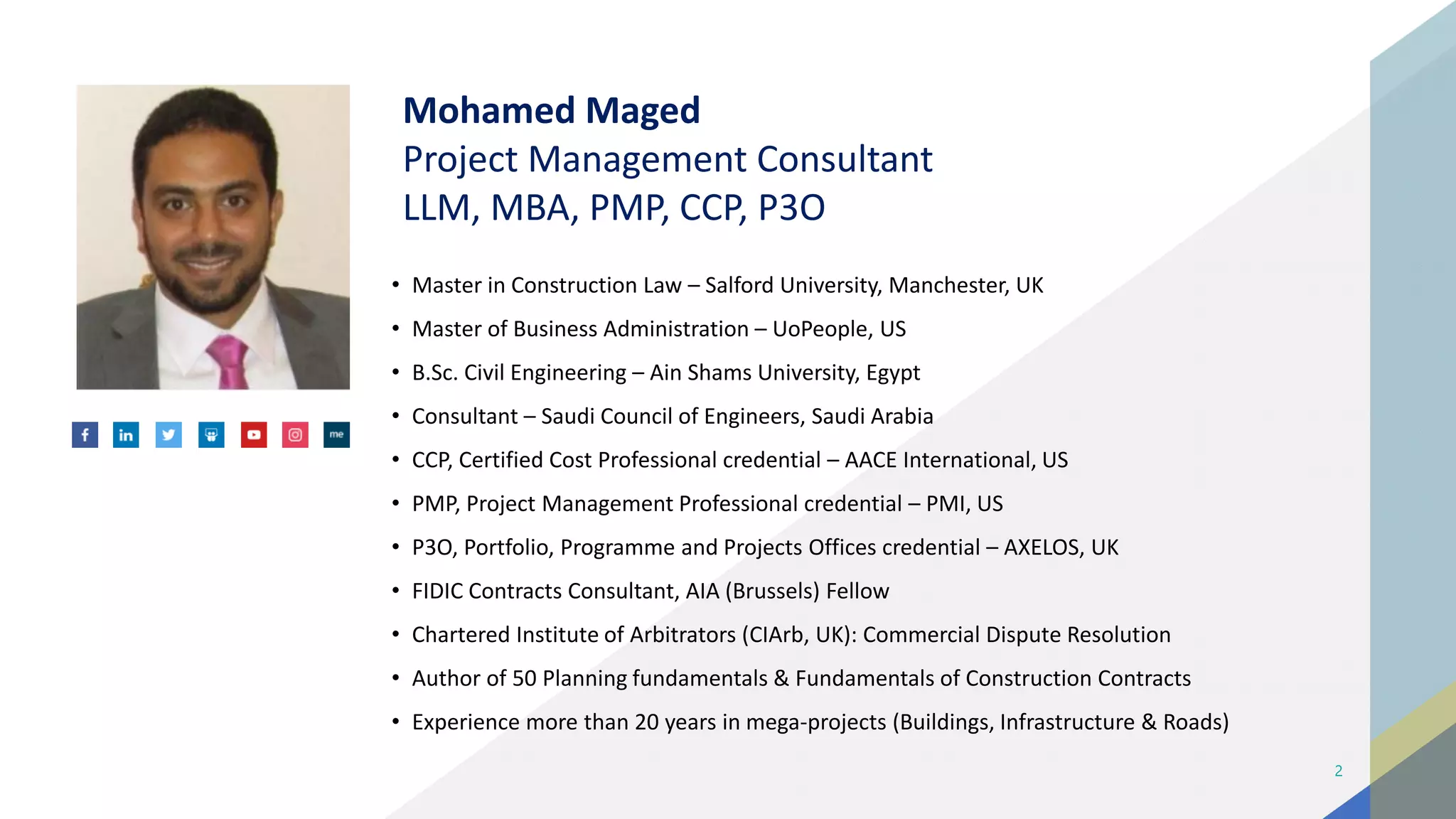

Mohamed Maged
Project Management Consultant
LLM, MBA, PMP, CCP, P3O
• Master in Construction Law – Salford University, Manchester, UK
• Master of Business Administration – UoPeople, US
• B.Sc. Civil Engineering – Ain Shams University, Egypt
• Consultant – Saudi Council of Engineers, Saudi Arabia
• CCP, Certified Cost Professional credential – AACE International, US
• PMP, Project Management Professional credential – PMI, US
• P3O, Portfolio, Programme and Projects Offices credential – AXELOS, UK
• FIDIC Contracts Consultant, AIA (Brussels) Fellow
• Chartered Institute of Arbitrators (CIArb, UK): Commercial Dispute Resolution
• Author of 50 Planning fundamentals & Fundamentals of Construction Contracts
• Experience more than 20 years in mega-projects (Buildings, Infrastructure & Roads)
@magedkom /in/magedkom ArabPlanners @profplanner
Content
1. Planning and scheduling
2. Time schedule development
3. Resource and cost loading
4. Time schedule submittal
5. Review and approval
6. Update and reporting
7. Delay quantification approaches
8. Mitigation and action plans

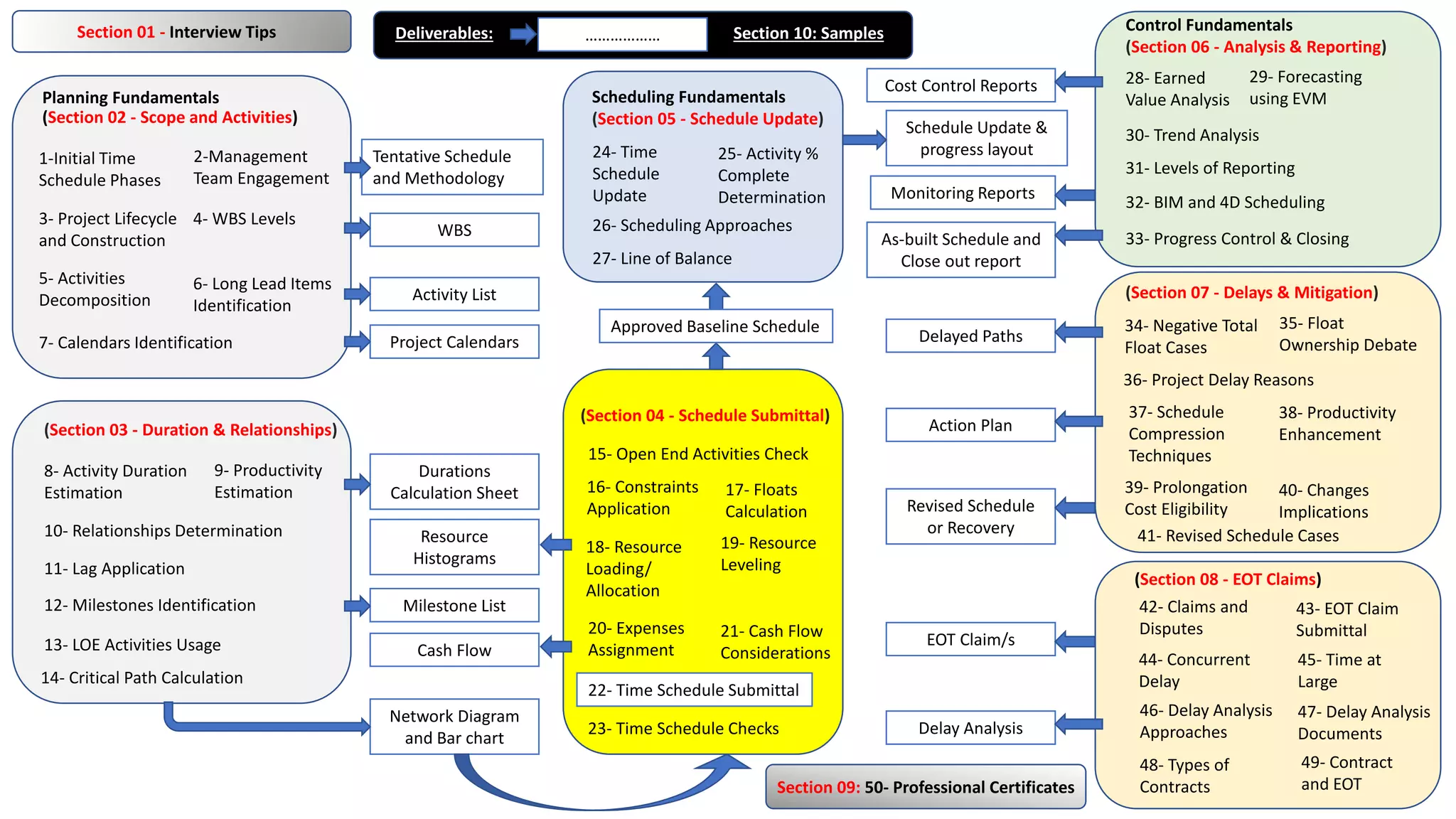

Planning Fundamentals
(Section 02 - Scope and Activities)
1-Initial Time
Schedule Phases
2-Management
Team Engagement
3- Project Lifecycle
and Construction
4- WBS Levels
5- Activities
Decomposition
7- Calendars Identification
6- Long Lead Items
Identification
(Section 03 - Duration & Relationships)
8- Activity Duration
Estimation
9- Productivity
Estimation
10- Relationships Determination
11- Lag Application
12- Milestones Identification
13- LOE Activities Usage
(Section 04 - Schedule Submittal)
14- Critical Path Calculation
15- Open End Activities Check
16- Constraints
Application
17- Floats
Calculation
18- Resource
Loading/
Allocation
19- Resource
Leveling
21- Cash Flow
Considerations
22- Time Schedule Submittal
23- Time Schedule Checks
20- Expenses
Assignment
Control Fundamentals
(Section 06 - Analysis & Reporting)
28- Earned
Value Analysis
29- Forecasting
using EVM
30- Trend Analysis
31- Levels of Reporting
32- BIM and 4D Scheduling
33- Progress Control & Closing
(Section 07 - Delays & Mitigation)
34- Negative Total
Float Cases
35- Float
Ownership Debate
36- Project Delay Reasons
37- Schedule
Compression
Techniques
38- Productivity
Enhancement
39- Prolongation
Cost Eligibility
40- Changes
Implications
41- Revised Schedule Cases
(Section 08 - EOT Claims)
42- Claims and
Disputes
43- EOT Claim
Submittal
44- Concurrent
Delay
45- Time at
Large
46- Delay Analysis
Approaches
47- Delay Analysis
Documents
48- Types of
Contracts
49- Contract
and EOT
Section 09: 50- Professional Certificates
Section 01 - Interview Tips
Tentative Schedule
and Methodology
WBS
Activity List
Durations
Calculation Sheet
Milestone List
Network Diagram
and Bar chart
Resource
Histograms
Cash Flow
Project Calendars
Scheduling Fundamentals
(Section 05 - Schedule Update)
24- Time
Schedule
Update
25- Activity %
Complete
Determination
26- Scheduling Approaches

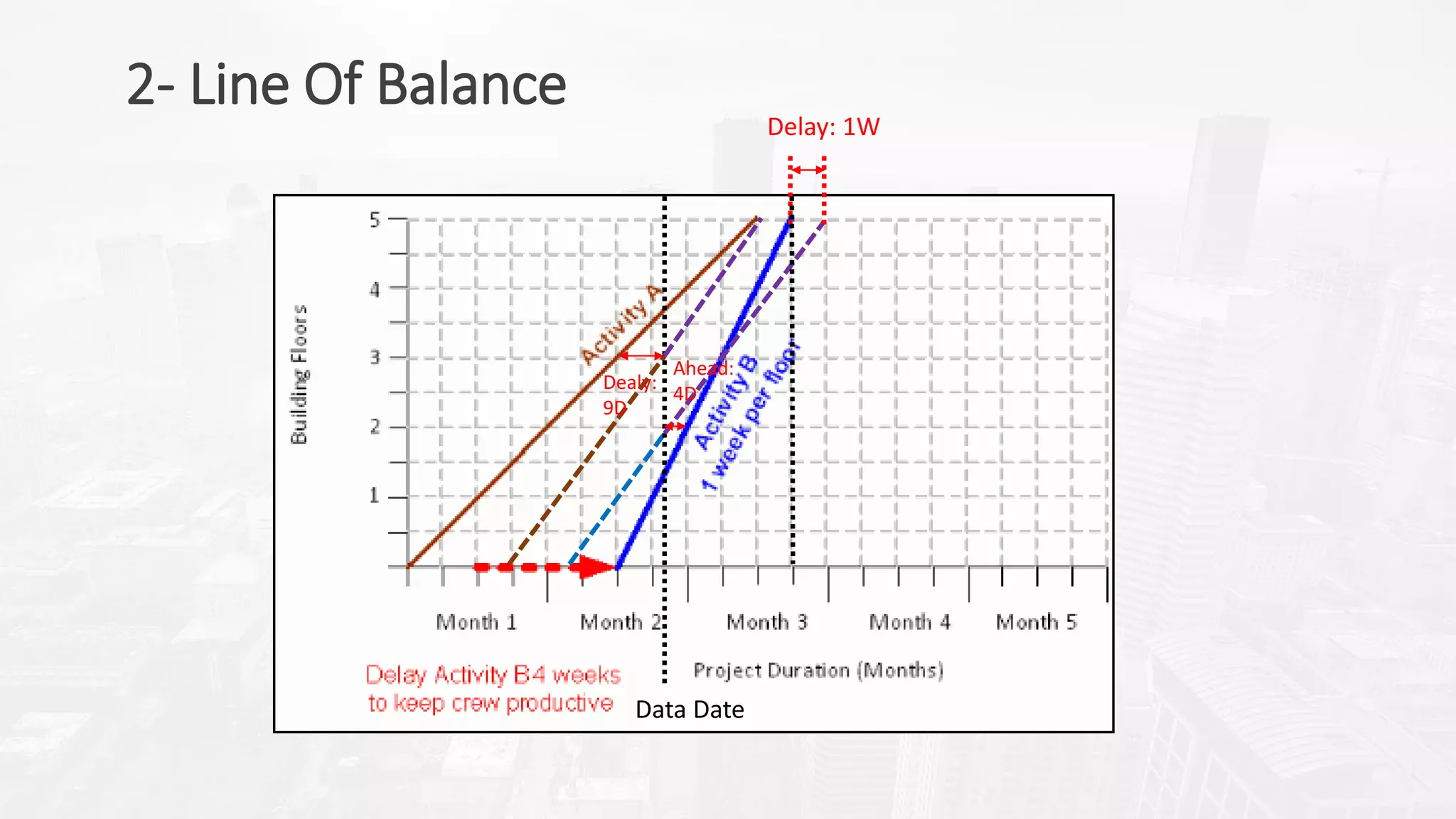

27- Line of Balance
Schedule Update &
progress layout
As-built Schedule and
Close out report
Monitoring Reports
Cost Control Reports
Delay Analysis
EOT Claim/s
Revised Schedule
or Recovery
Action Plan
Delayed Paths
Deliverables:
Approved Baseline Schedule
……………… Section 10: Samples
@magedkom /in/magedkom ArabPlanners @profplanner

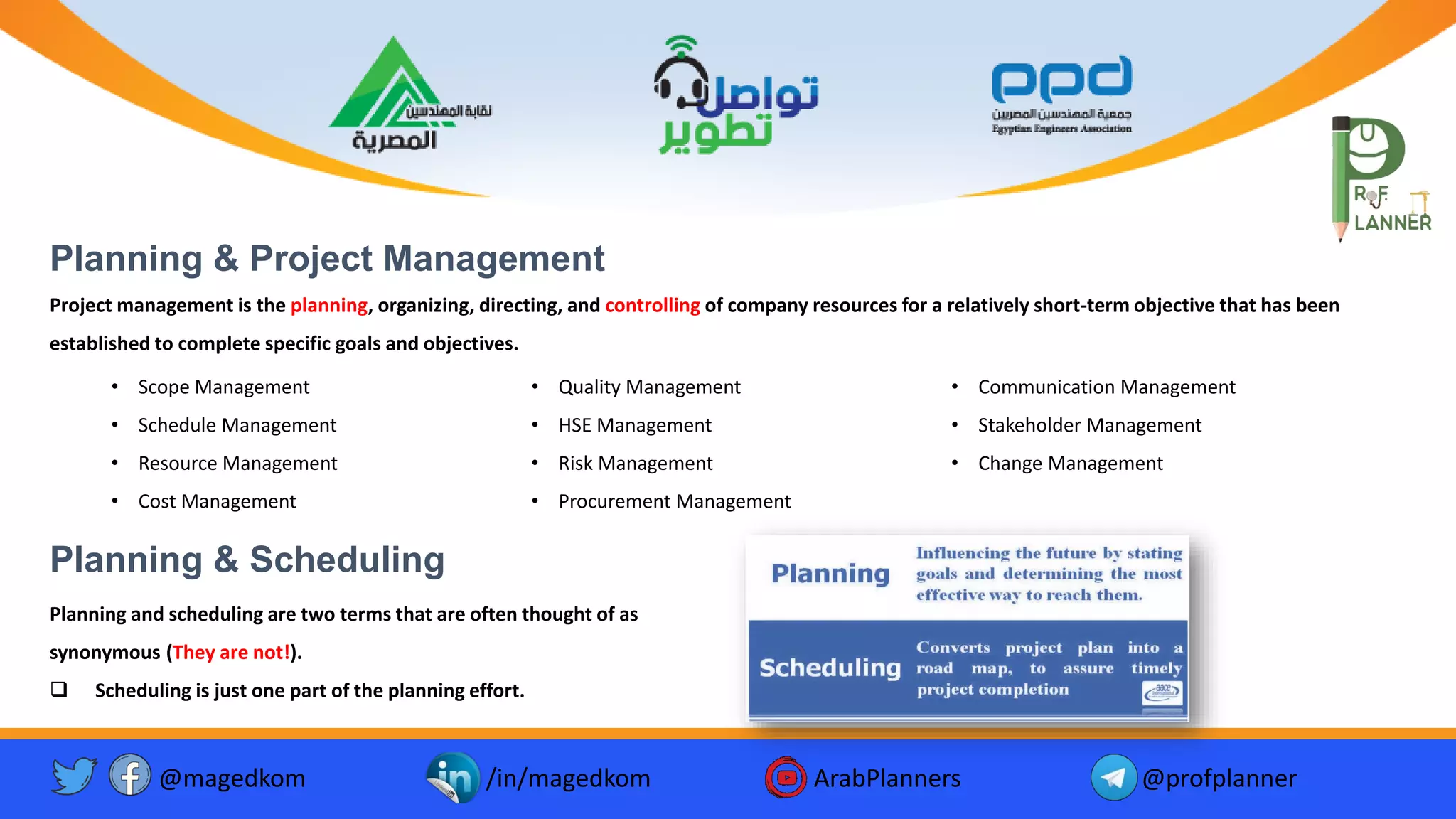

Planning & Project Management
• Scope Management
• Schedule Management
• Resource Management
• Cost Management
• Quality Management
• HSE Management
• Risk Management
• Procurement Management
• Communication Management
• Stakeholder Management
• Change Management
Planning & Scheduling
Planning and scheduling are two terms that are often thought of as
synonymous (They are not!).
❑ Scheduling is just one part of the planning effort.
Project management is the planning, organizing, directing, and controlling of company resources for a relatively short-term objective that has been
established to complete specific goals and objectives.

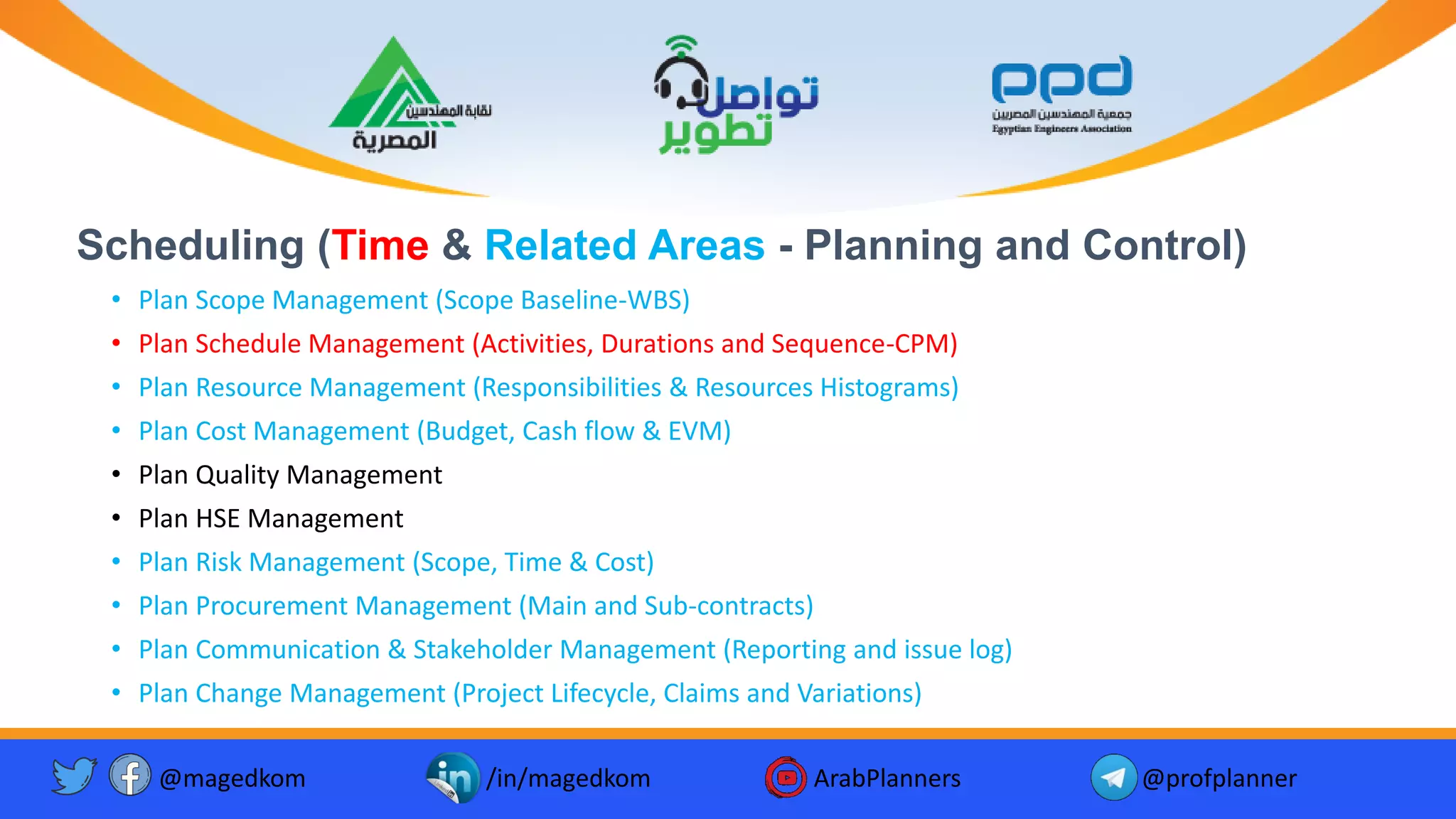

Scheduling (Time & Related Areas - Planning and Control)
• Plan Scope Management (Scope Baseline-WBS)
• Plan Schedule Management (Activities, Durations and Sequence-CPM)
• Plan Resource Management (Responsibilities & Resources Histograms)
• Plan Cost Management (Budget, Cash flow & EVM)
• Plan Quality Management
• Plan HSE Management
• Plan Risk Management (Scope, Time & Cost)
• Plan Procurement Management (Main and Sub-contracts)
• Plan Communication & Stakeholder Management (Reporting and issue log)
• Plan Change Management (Project Lifecycle, Claims and Variations)
@magedkom /in/magedkom ArabPlanners @profplanner

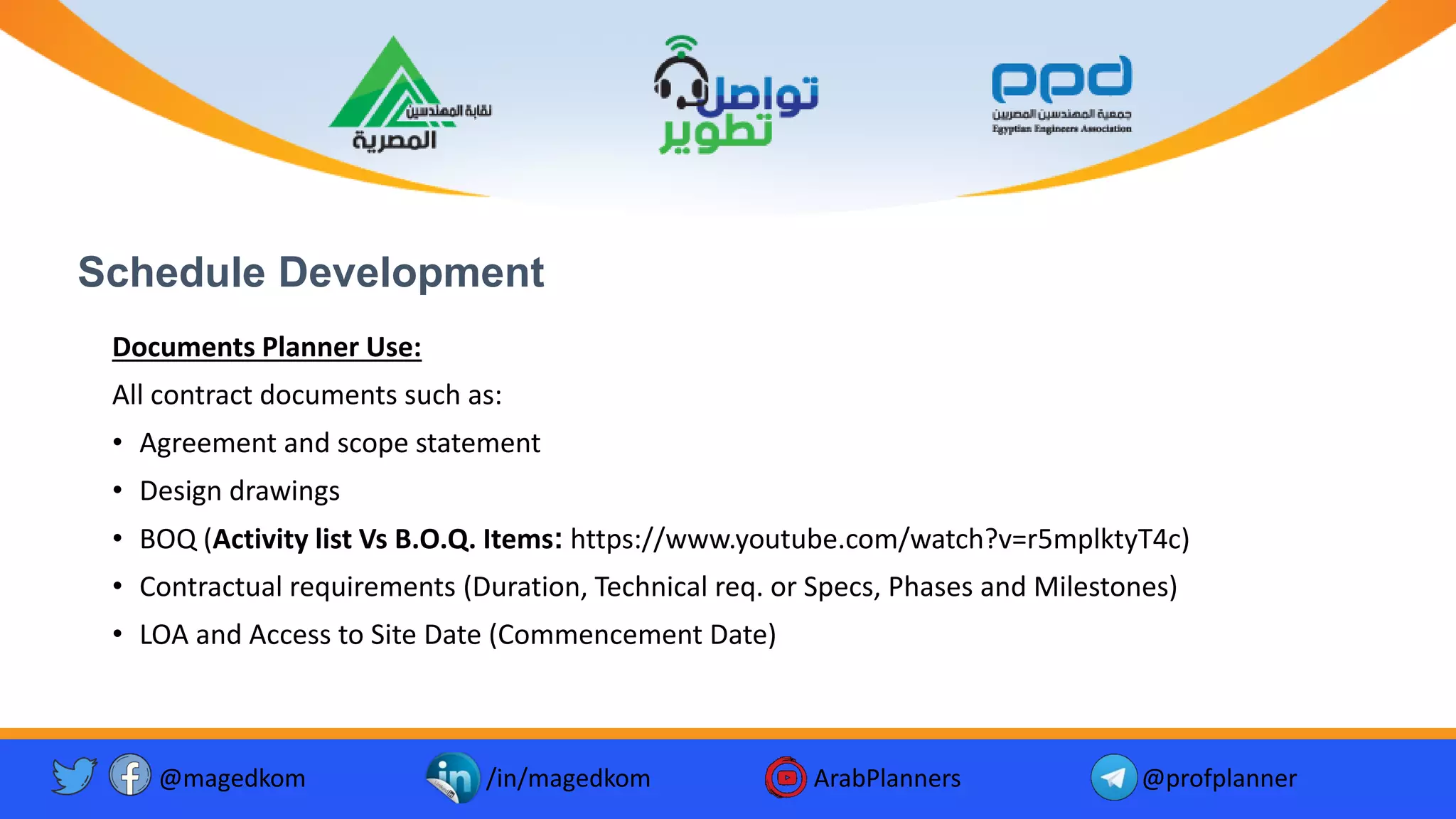

Schedule Development
Documents Planner Use:
All contract documents such as:
• Agreement and scope statement
• Design drawings
• BOQ (Activity list Vs B.O.Q. Items: https://www.youtube.com/watch?v=r5mplktyT4c)
• Contractual requirements (Duration, Technical req. or Specs, Phases and Milestones)
• LOA and Access to Site Date (Commencement Date)
@magedkom /in/magedkom ArabPlanners @profplanner

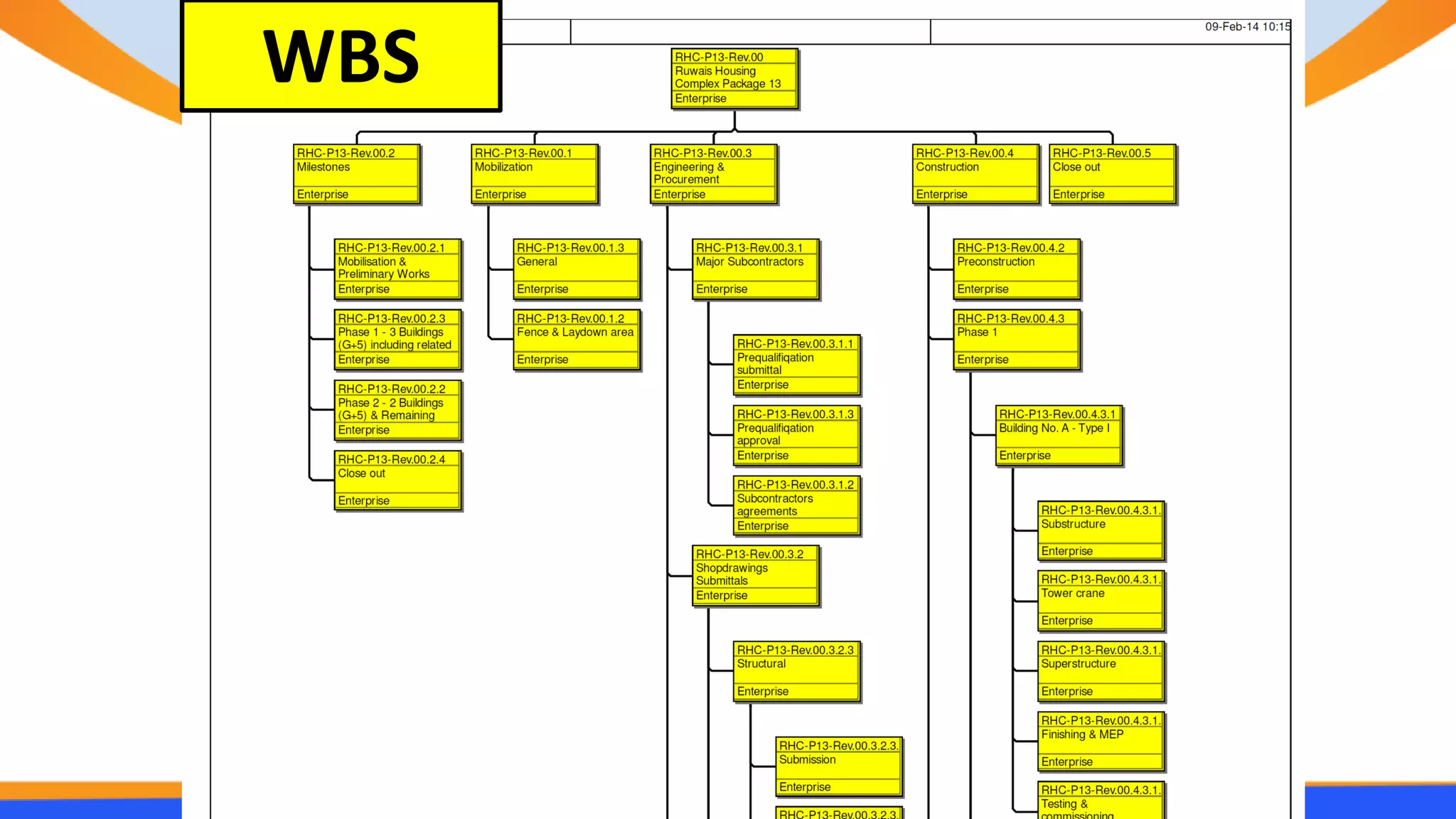

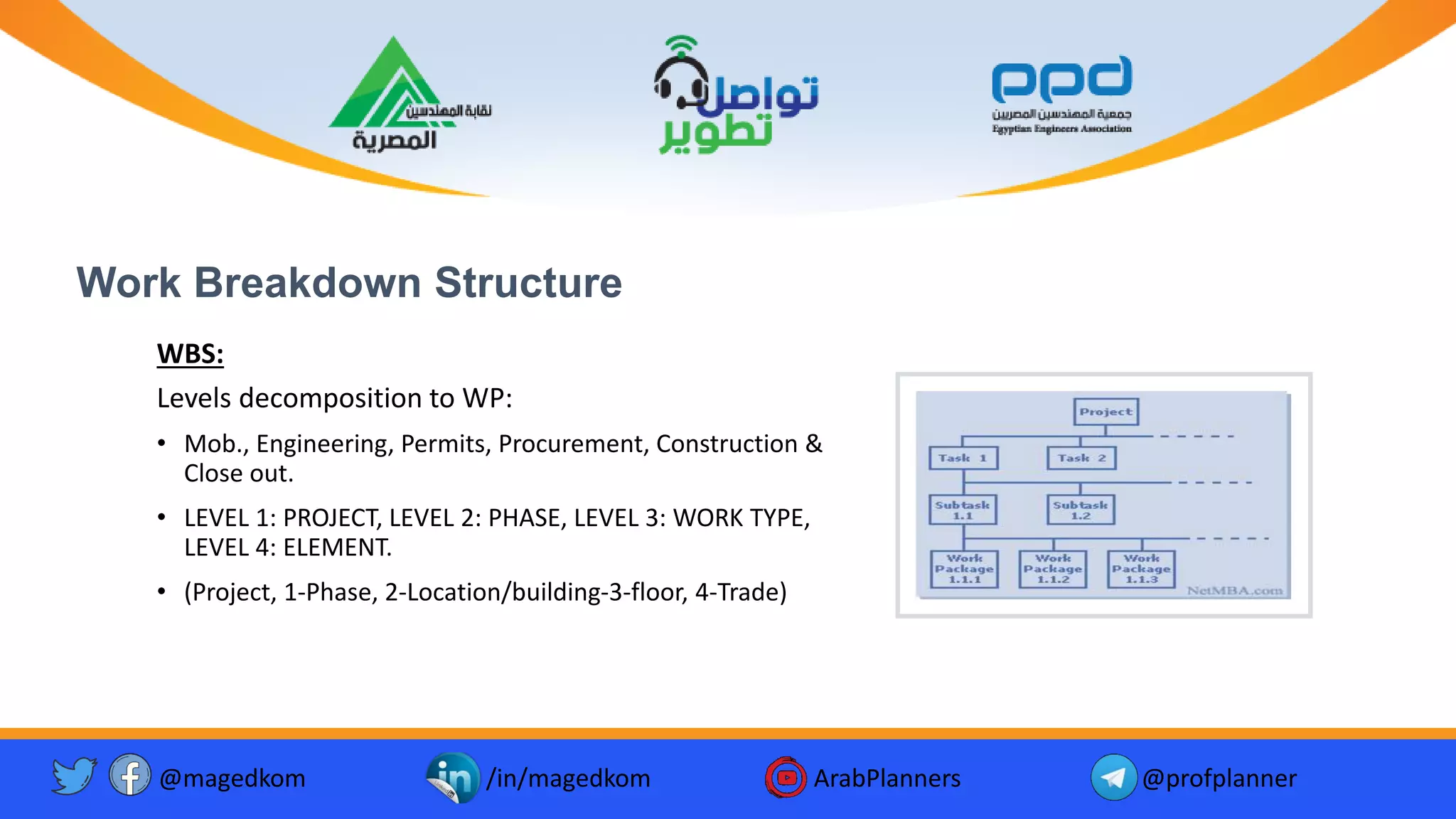

Work Breakdown Structure
WBS:
Levels decomposition to WP:
• Mob., Engineering, Permits, Procurement, Construction &
Close out.
• LEVEL 1: PROJECT, LEVEL 2: PHASE, LEVEL 3: WORK TYPE,
LEVEL 4: ELEMENT.
• (Project, 1-Phase, 2-Location/building-3-floor, 4-Trade)
@magedkom /in/magedkom ArabPlanners @profplanner

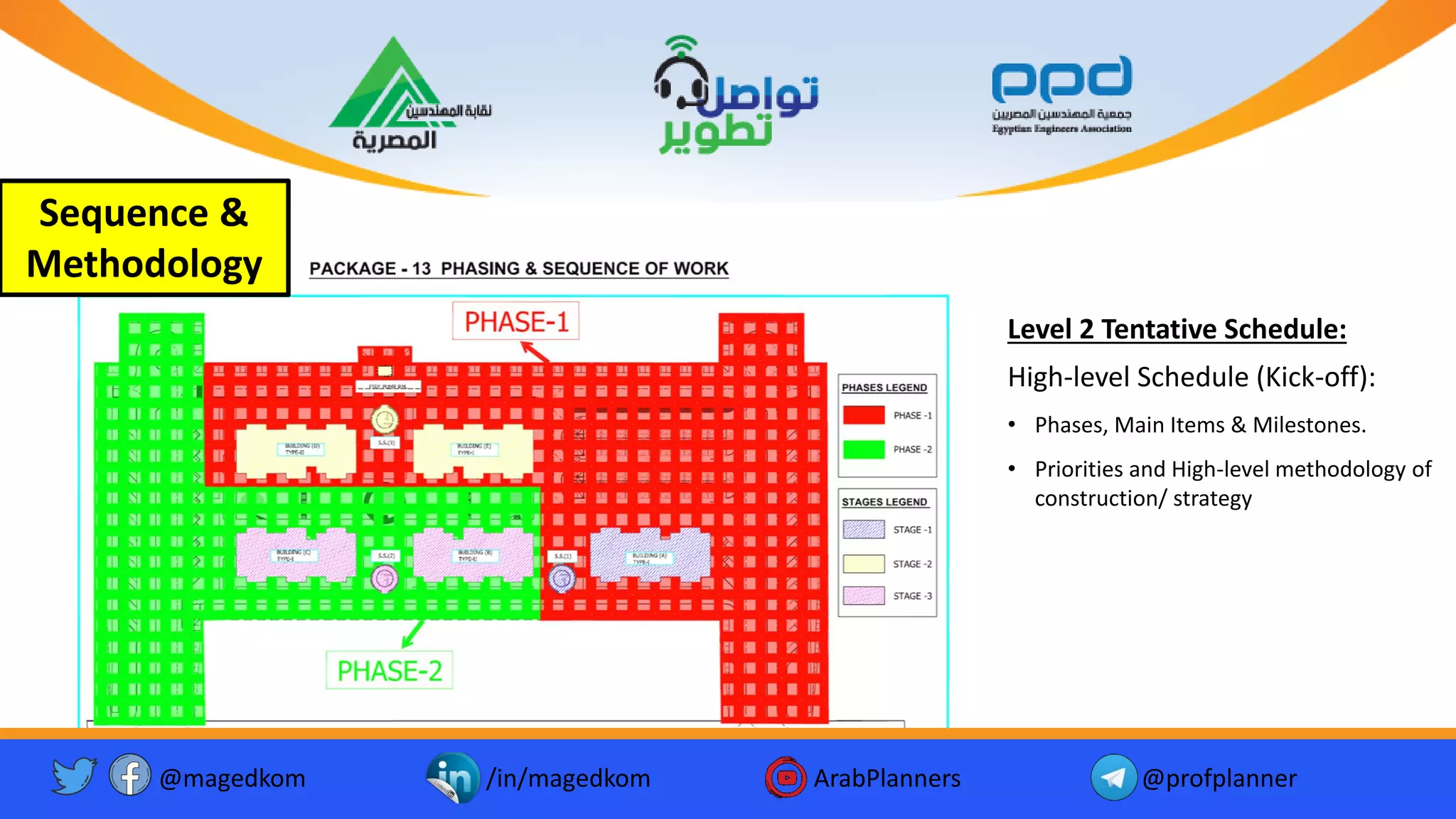

Sequence &
Methodology
@magedkom /in/magedkom ArabPlanners @profplanner
Level 2 Tentative Schedule:
High-level Schedule (Kick-off):
• Phases, Main Items & Milestones.
• Priorities and High-level methodology of
construction/ strategy
WBS

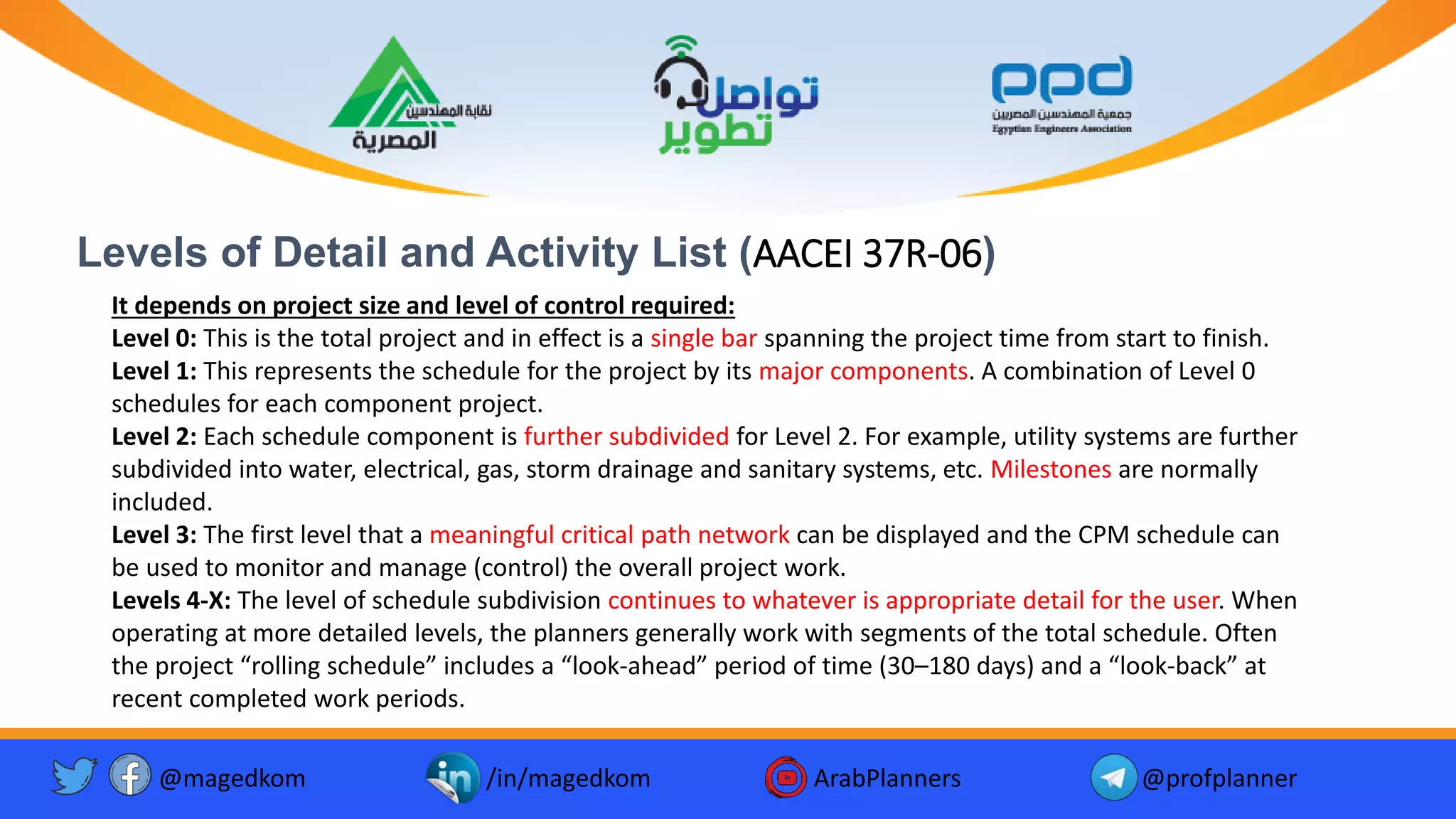

Levels of Detail and Activity List (AACEI 37R-06)
@magedkom /in/magedkom ArabPlanners @profplanner
It depends on project size and level of control required:
Level 0: This is the total project and in effect is a single bar spanning the project time from start to finish.
Level 1: This represents the schedule for the project by its major components. A combination of Level 0
schedules for each component project.
Level 2: Each schedule component is further subdivided for Level 2. For example, utility systems are further
subdivided into water, electrical, gas, storm drainage and sanitary systems, etc. Milestones are normally
included.
Level 3: The first level that a meaningful critical path network can be displayed and the CPM schedule can
be used to monitor and manage (control) the overall project work.
Levels 4-X: The level of schedule subdivision continues to whatever is appropriate detail for the user. When
operating at more detailed levels, the planners generally work with segments of the total schedule. Often
the project “rolling schedule” includes a “look-ahead” period of time (30–180 days) and a “look-back” at
recent completed work periods.

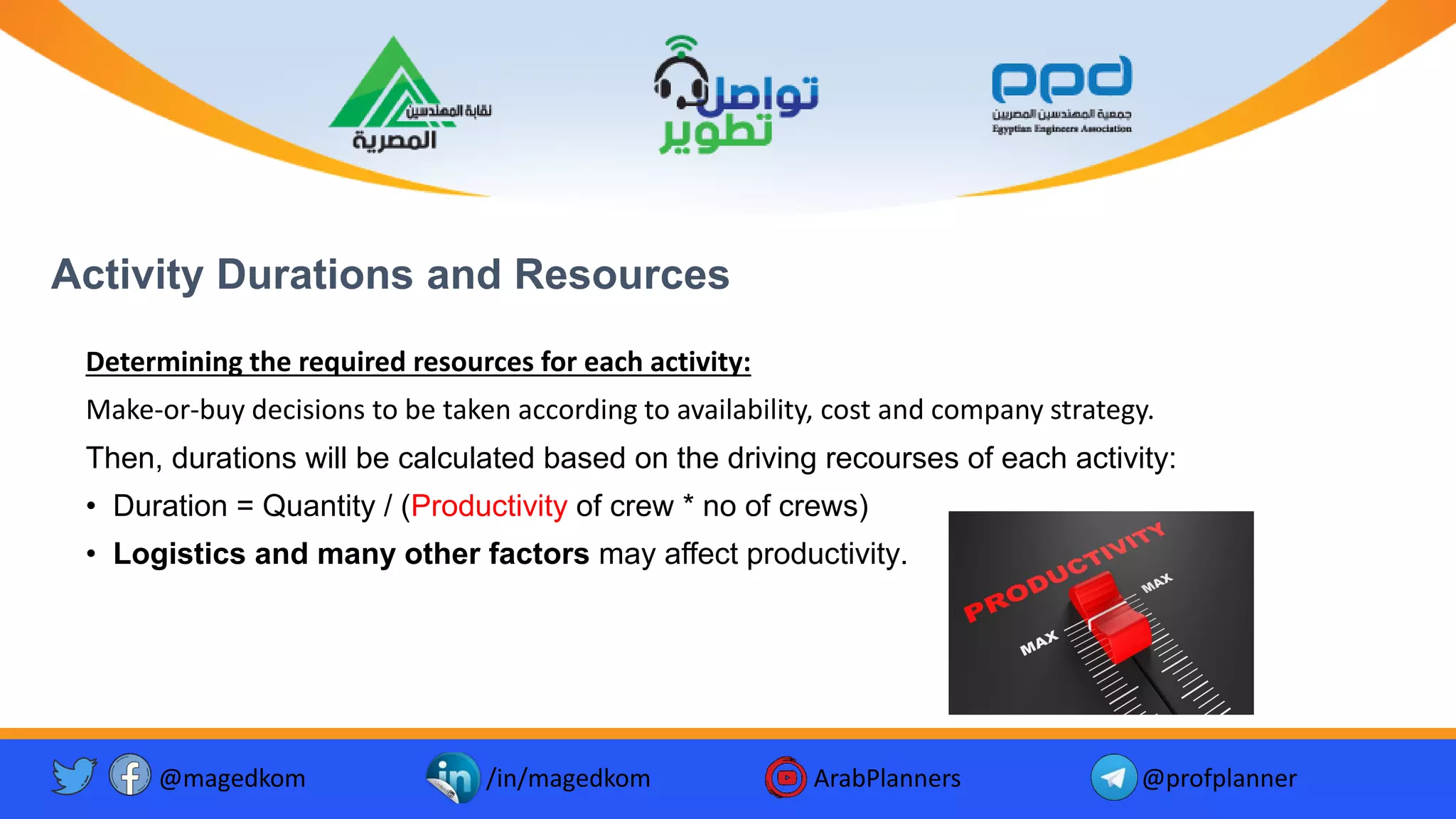

Activity Durations and Resources
Determining the required resources for each activity:
Make-or-buy decisions to be taken according to availability, cost and company strategy.
Then, durations will be calculated based on the driving recourses of each activity:
• Duration = Quantity / (Productivity of crew * no of crews)
• Logistics and many other factors may affect productivity.
@magedkom /in/magedkom ArabPlanners @profplanner

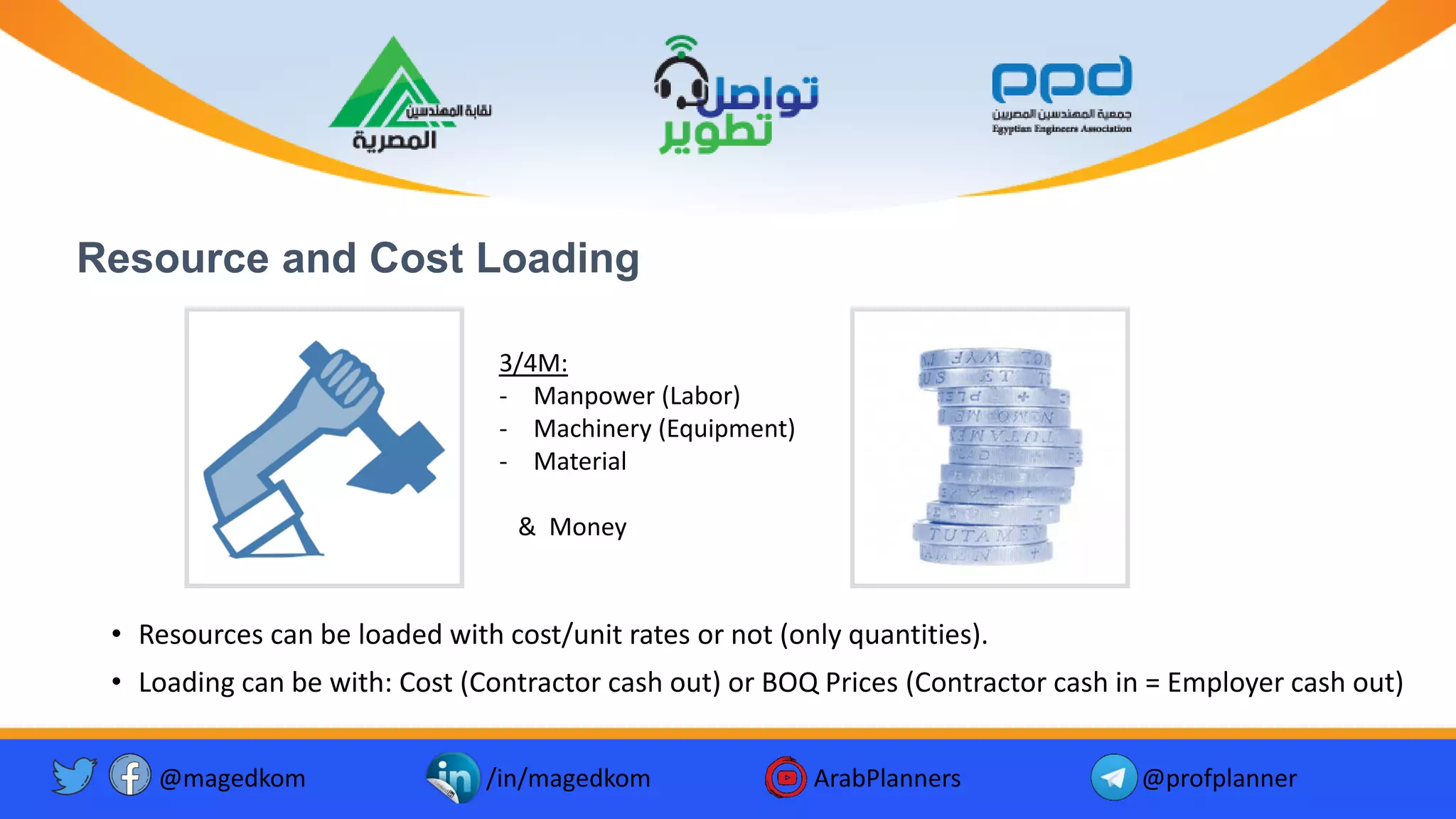

Resource and Cost Loading
• Resources can be loaded with cost/unit rates or not (only quantities).
• Loading can be with: Cost (Contractor cash out) or BOQ Prices (Contractor cash in = Employer cash out)
3/4M:
- Manpower (Labor)
- Machinery (Equipment)
- Material
& Money
@magedkom /in/magedkom ArabPlanners @profplanner

Productivity Sheets
@magedkom /in/magedkom ArabPlanners @profplanner

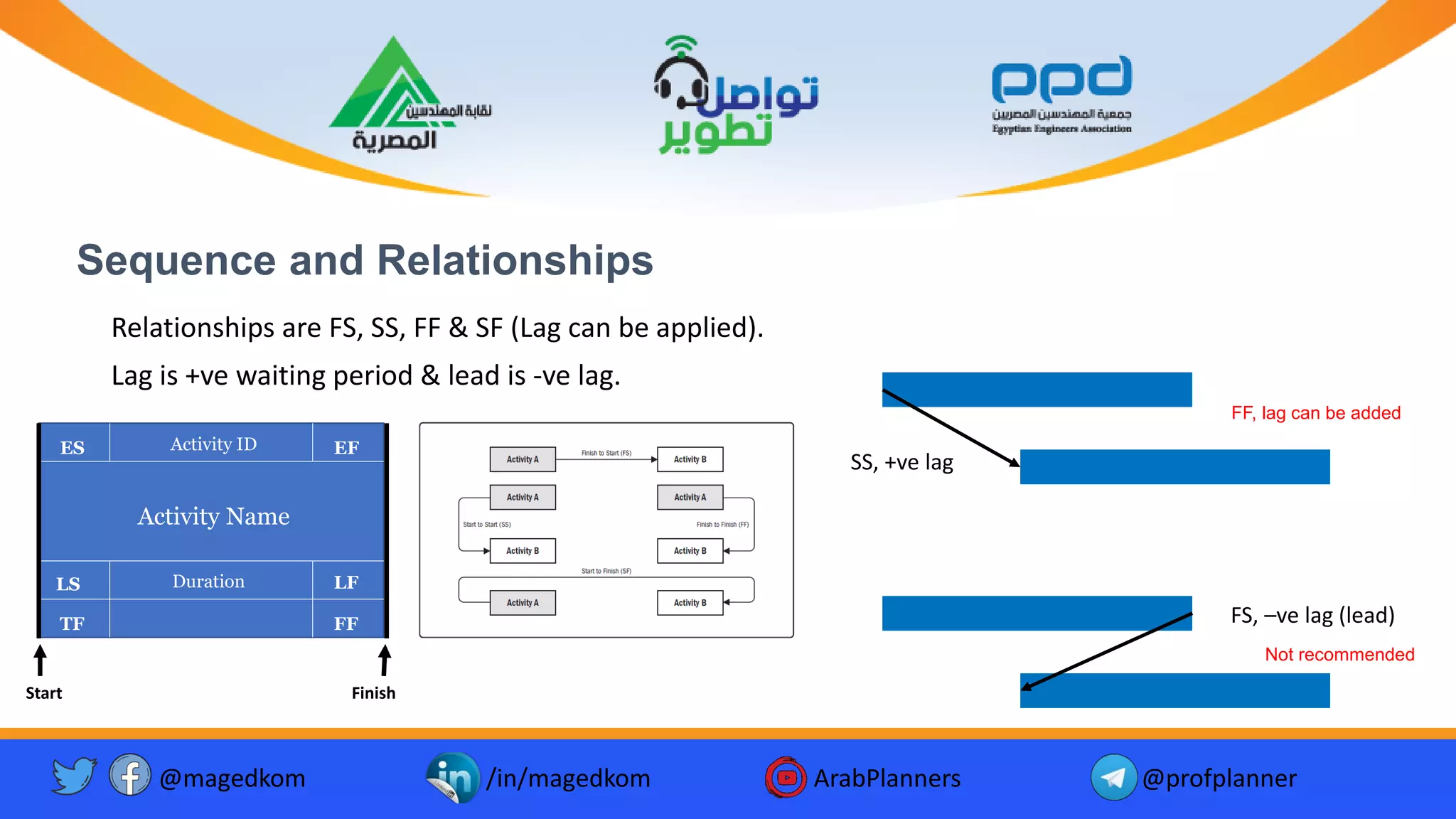

Sequence and Relationships
Relationships are FS, SS, FF & SF (Lag can be applied).
Lag is +ve waiting period & lead is -ve lag.
Activity Name
Activity ID
Duration
ES EF
LS LF
TF FF
Finish
Start
SS, +ve lag
FS, –ve lag (lead)
Not recommended
FF, lag can be added
@magedkom /in/magedkom ArabPlanners @profplanner

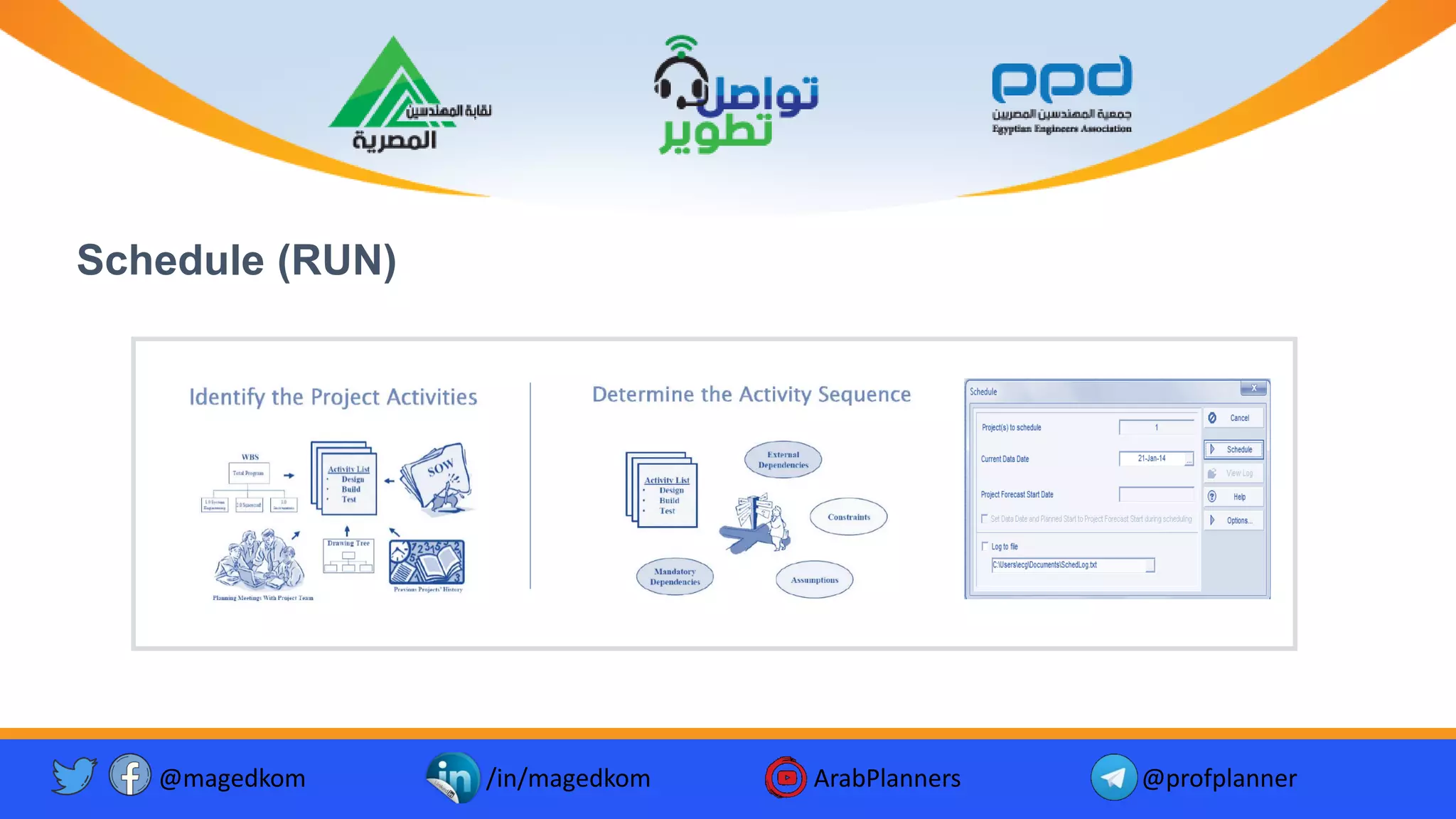

Schedule (RUN)
@magedkom /in/magedkom ArabPlanners @profplanner

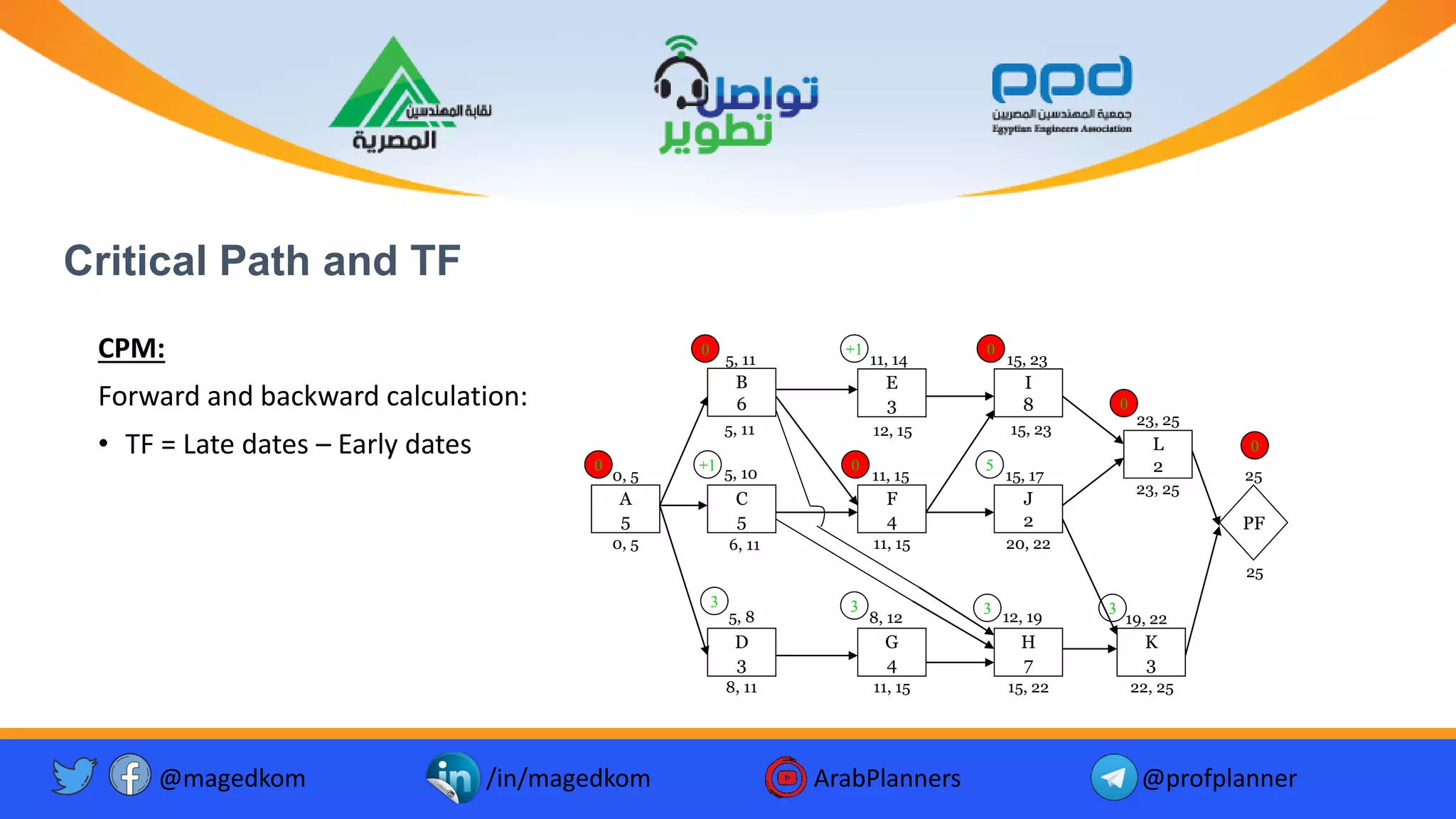

Critical Path and TF
CPM:
Forward and backward calculation:
• TF = Late dates – Early dates
A
5
D
3
C
5
G
4
E
3
F
4
H
7
I
8
J
2
K
3
L
2
PF
0, 5
0, 5
5, 11
5, 10
5, 8
11, 15
11, 14
8, 12
15, 17
15, 23
12, 19
23, 25
19, 22
25
23, 25
22, 25
15, 23
20, 22
15, 22
12, 15
11, 15
11, 15
5, 11
6, 11
8, 11
0
0
0
+1 0
0
+1 5
3 3 3 3
25
B
6
0
@magedkom /in/magedkom ArabPlanners @profplanner

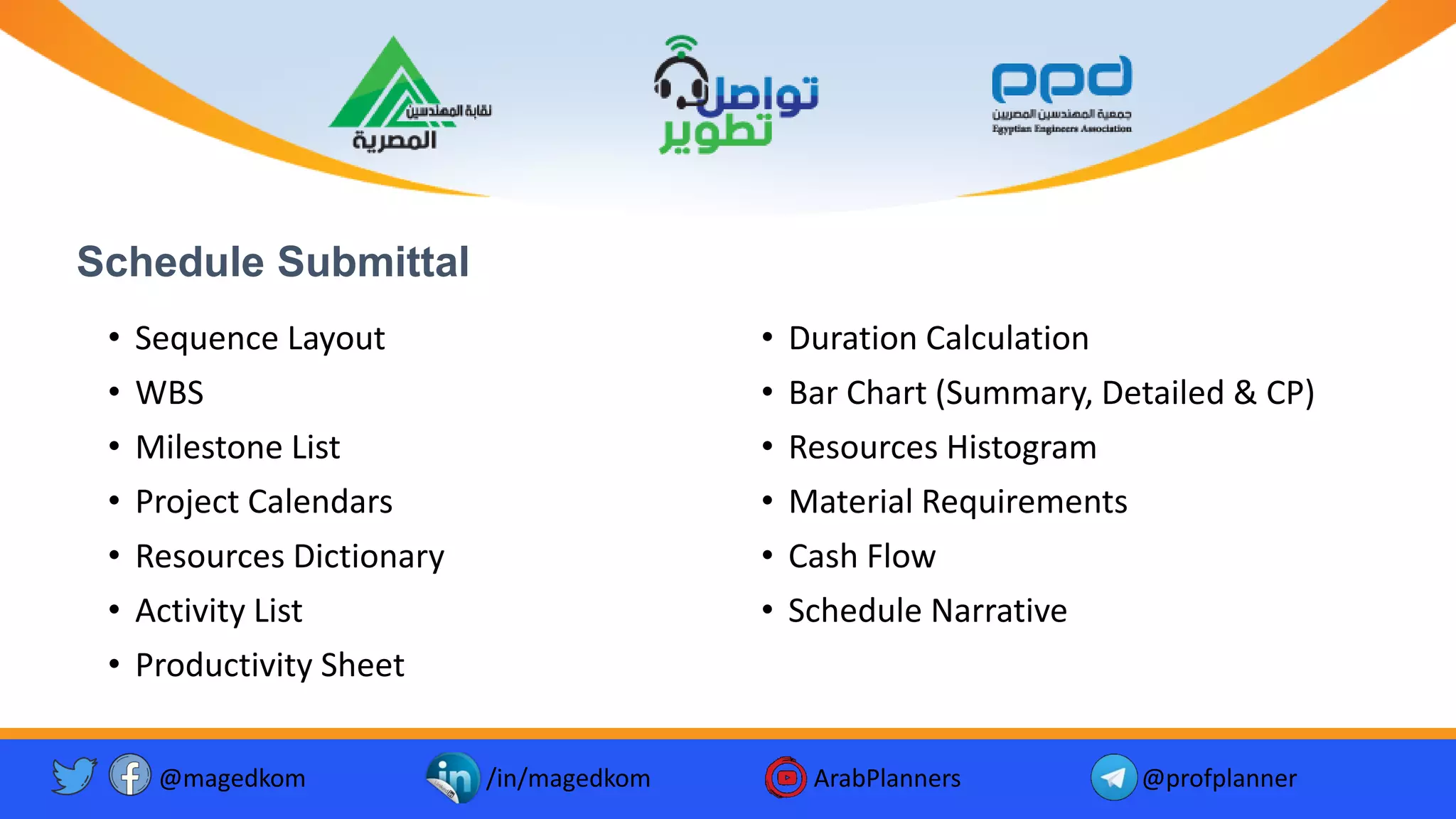

Schedule Submittal
• Sequence Layout
• WBS
• Milestone List
• Project Calendars
• Resources Dictionary
• Activity List
• Productivity Sheet
• Duration Calculation
• Bar Chart (Summary, Detailed & CP)
• Resources Histogram
• Material Requirements
• Cash Flow
• Schedule Narrative
@magedkom /in/magedkom ArabPlanners @profplanner

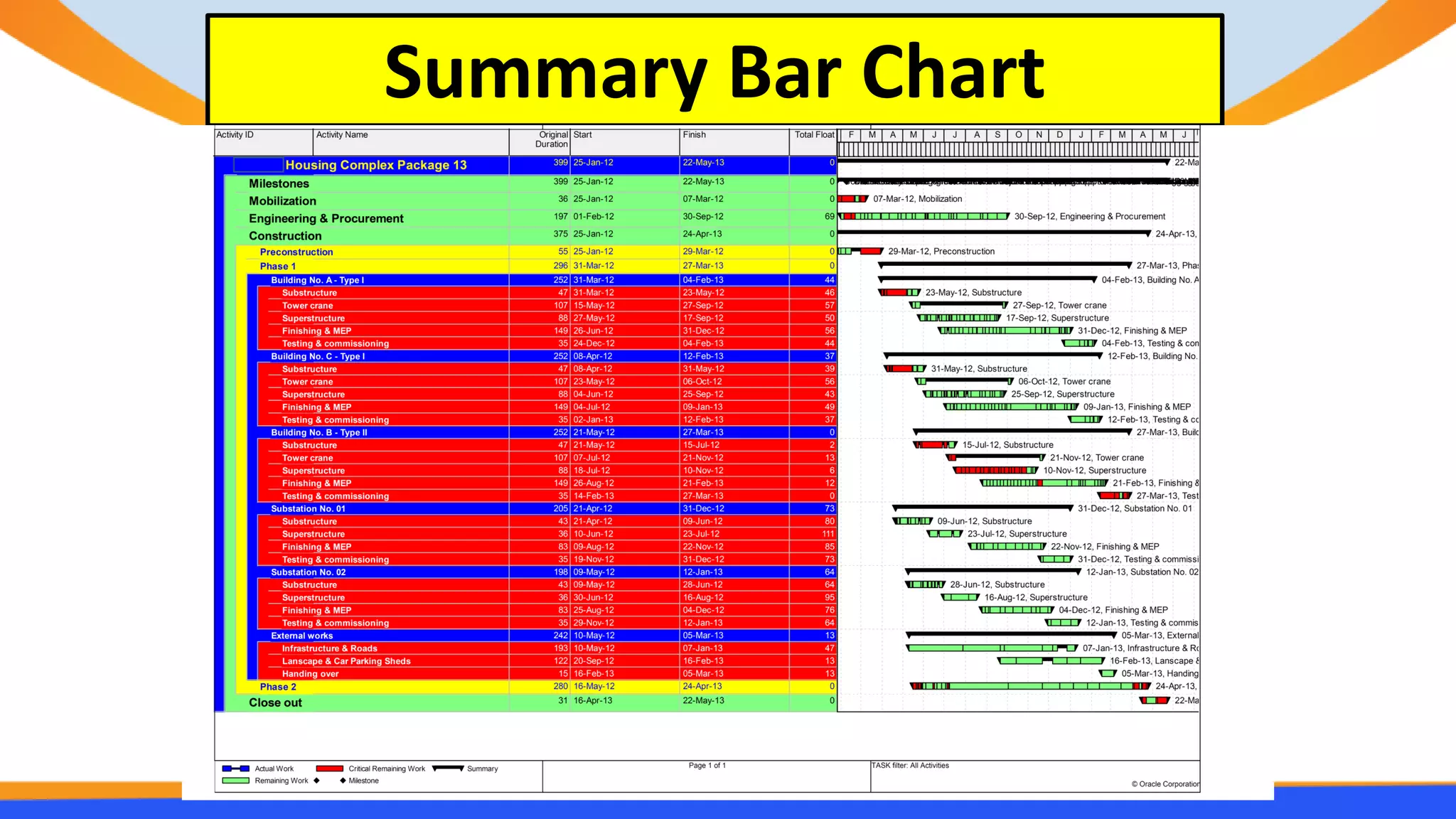

Summary Bar Chart

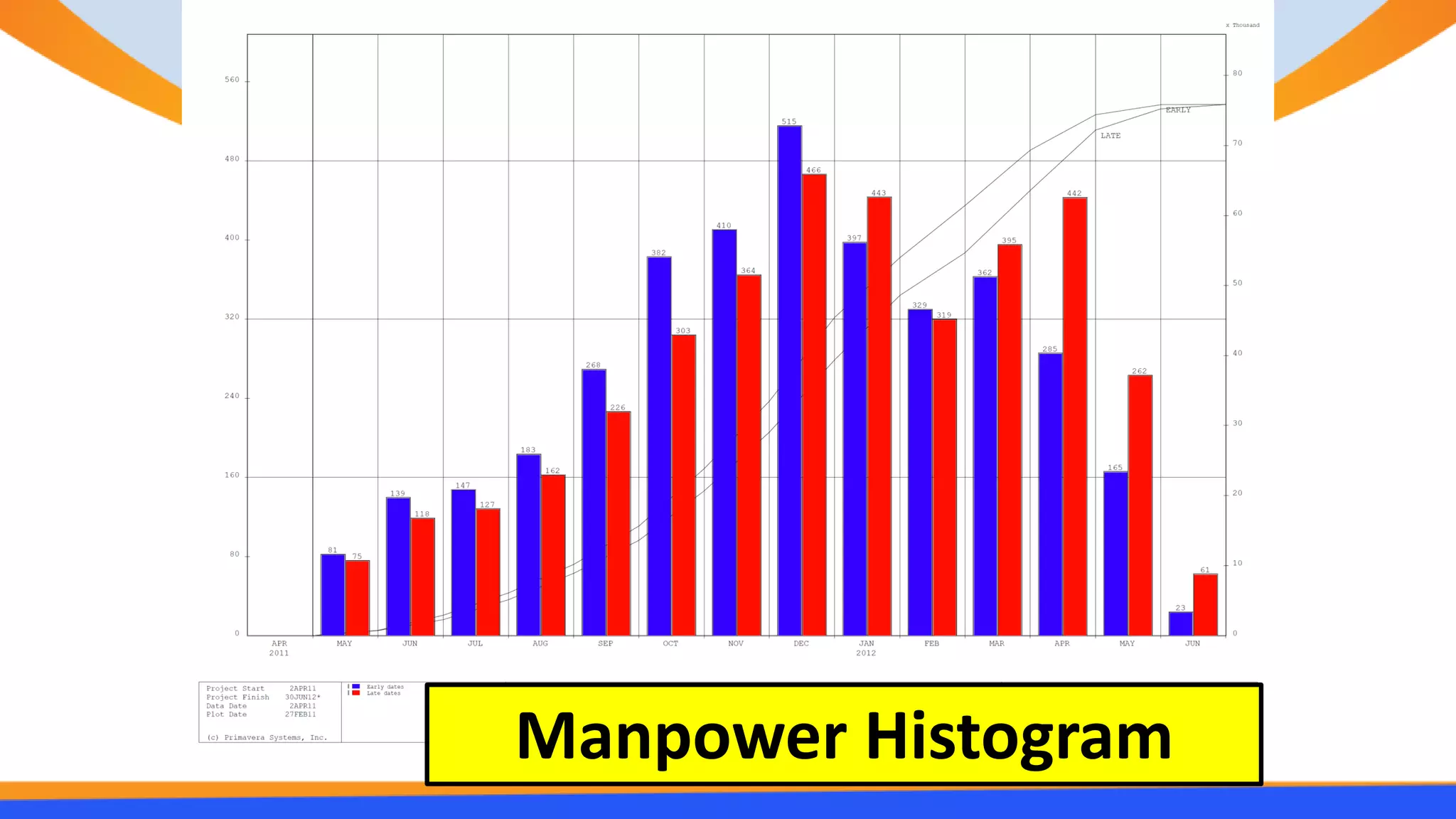

Manpower Histogram
Review and Approval

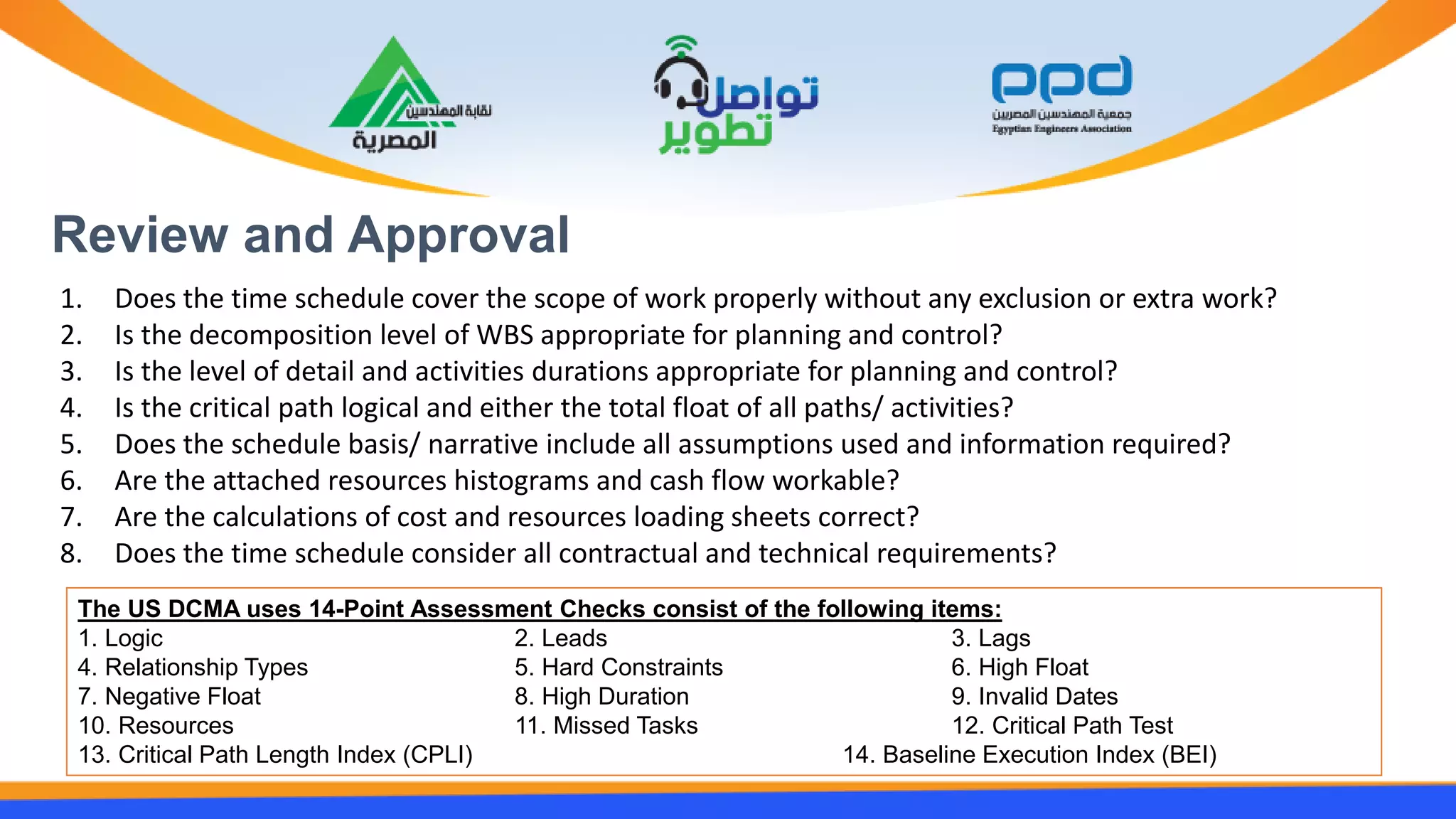

1. Does the time schedule cover the scope of work properly without any exclusion or extra work?
2. Is the decomposition level of WBS appropriate for planning and control?
3. Is the level of detail and activities durations appropriate for planning and control?
4. Is the critical path logical and either the total float of all paths/ activities?
5. Does the schedule basis/ narrative include all assumptions used and information required?
6. Are the attached resources histograms and cash flow workable?
7. Are the calculations of cost and resources loading sheets correct?
8. Does the time schedule consider all contractual and technical requirements?
The US DCMA uses 14-Point Assessment Checks consist of the following items:
1. Logic 2. Leads 3. Lags
4. Relationship Types 5. Hard Constraints 6. High Float
7. Negative Float 8. High Duration 9. Invalid Dates
10. Resources 11. Missed Tasks 12. Critical Path Test
13. Critical Path Length Index (CPLI) 14. Baseline Execution Index (BEI)
Bz

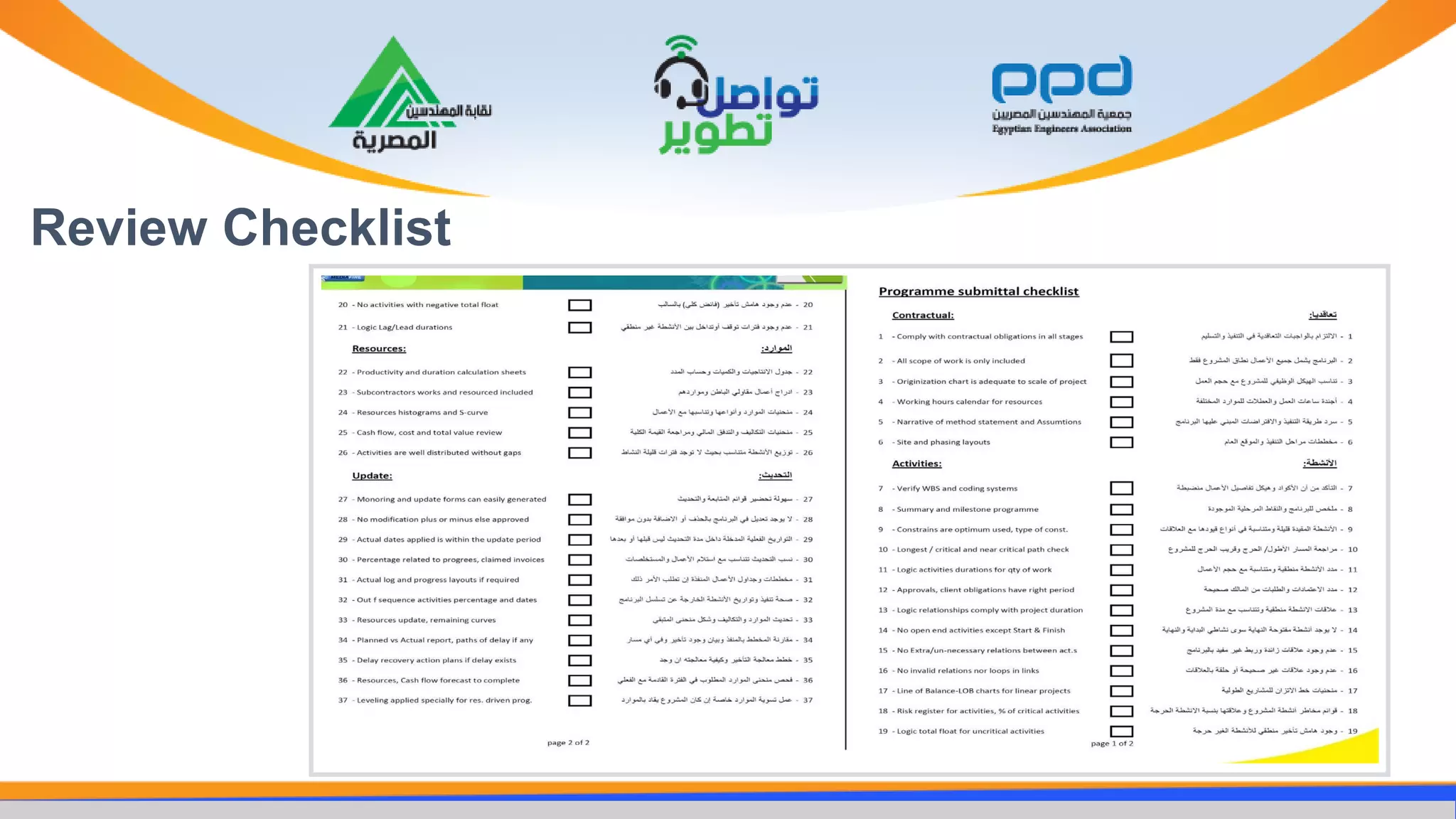

Review Checklist
Planning team monitors all items
related to time schedule which
may impact the project duration
such as progress, sequence of
work, resources, productivity,
EV, risks, procurement, changes
… etc.
They normally prepare reports in
this regard with the expected
impact and proposed corrective
actions.
Monitoring and Control
@magedkom /in/magedkom ArabPlanners @profplanner

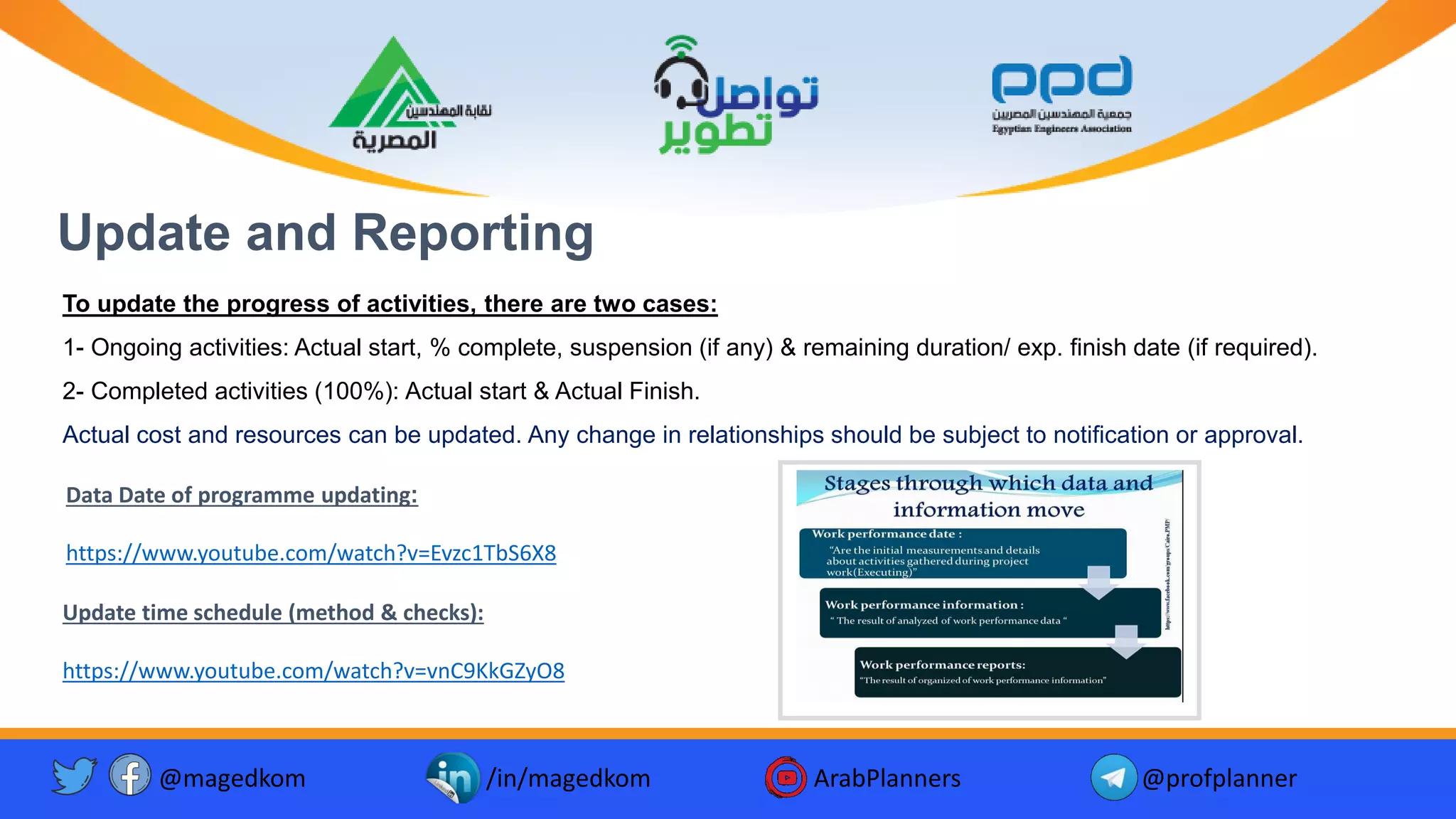

To update the progress of activities, there are two cases:
1- Ongoing activities: Actual start, % complete, suspension (if any) & remaining duration/ exp. finish date (if required).
2- Completed activities (100%): Actual start & Actual Finish.
Actual cost and resources can be updated. Any change in relationships should be subject to notification or approval.
Data Date of programme updating:
https://www.youtube.com/watch?v=Evzc1TbS6X8
Update time schedule (method & checks):
https://www.youtube.com/watch?v=vnC9KkGZyO8
Update and Reporting
@magedkom /in/magedkom ArabPlanners @profplanner

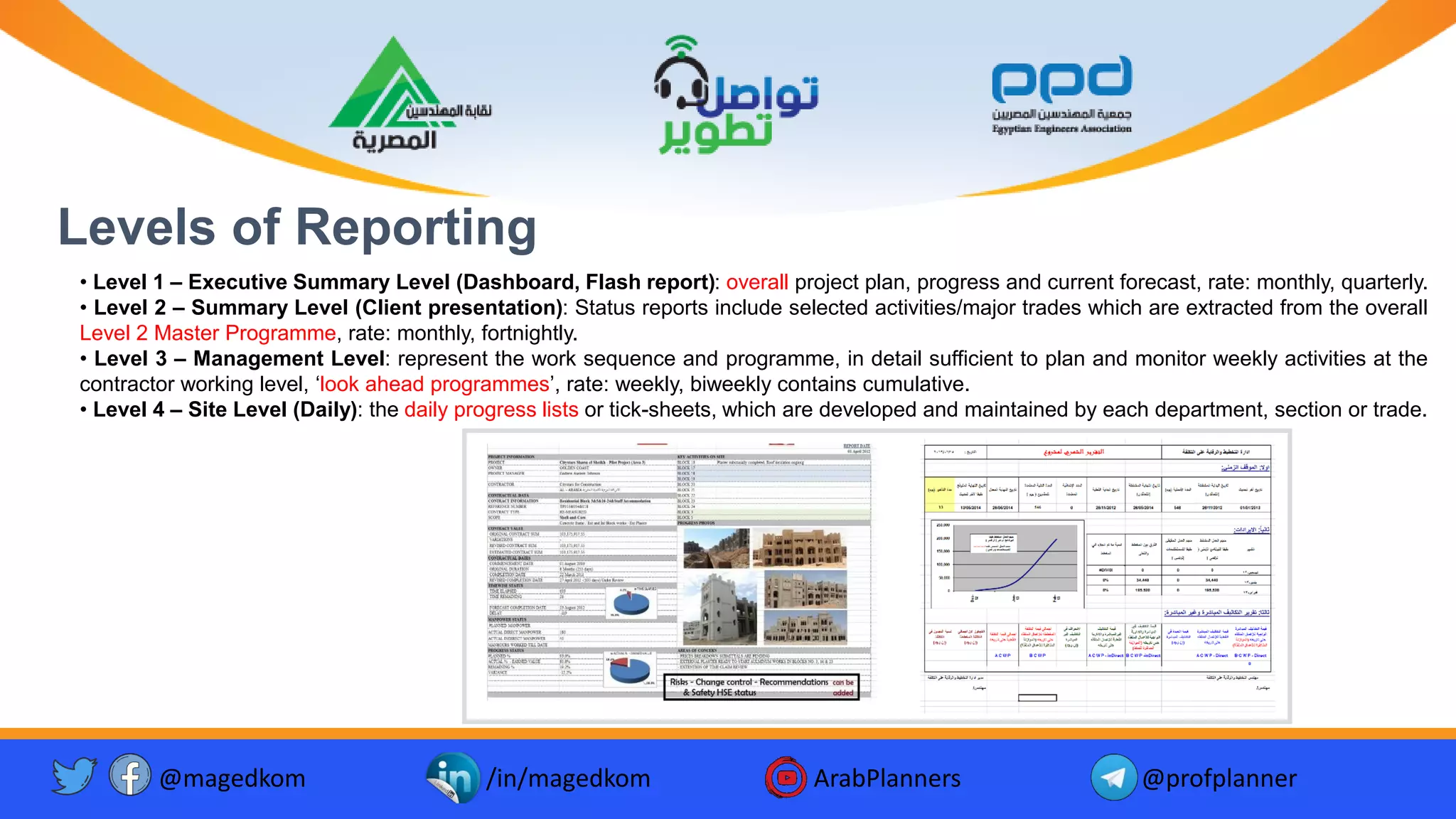

• Level 1 – Executive Summary Level (Dashboard, Flash report): overall project plan, progress and current forecast, rate: monthly, quarterly.
• Level 2 – Summary Level (Client presentation): Status reports include selected activities/major trades which are extracted from the overall
Level 2 Master Programme, rate: monthly, fortnightly.
• Level 3 – Management Level: represent the work sequence and programme, in detail sufficient to plan and monitor weekly activities at the
contractor working level, ‘look ahead programmes’, rate: weekly, biweekly contains cumulative.
• Level 4 – Site Level (Daily): the daily progress lists or tick-sheets, which are developed and maintained by each department, section or trade.
Levels of Reporting
@magedkom /in/magedkom ArabPlanners @profplanner

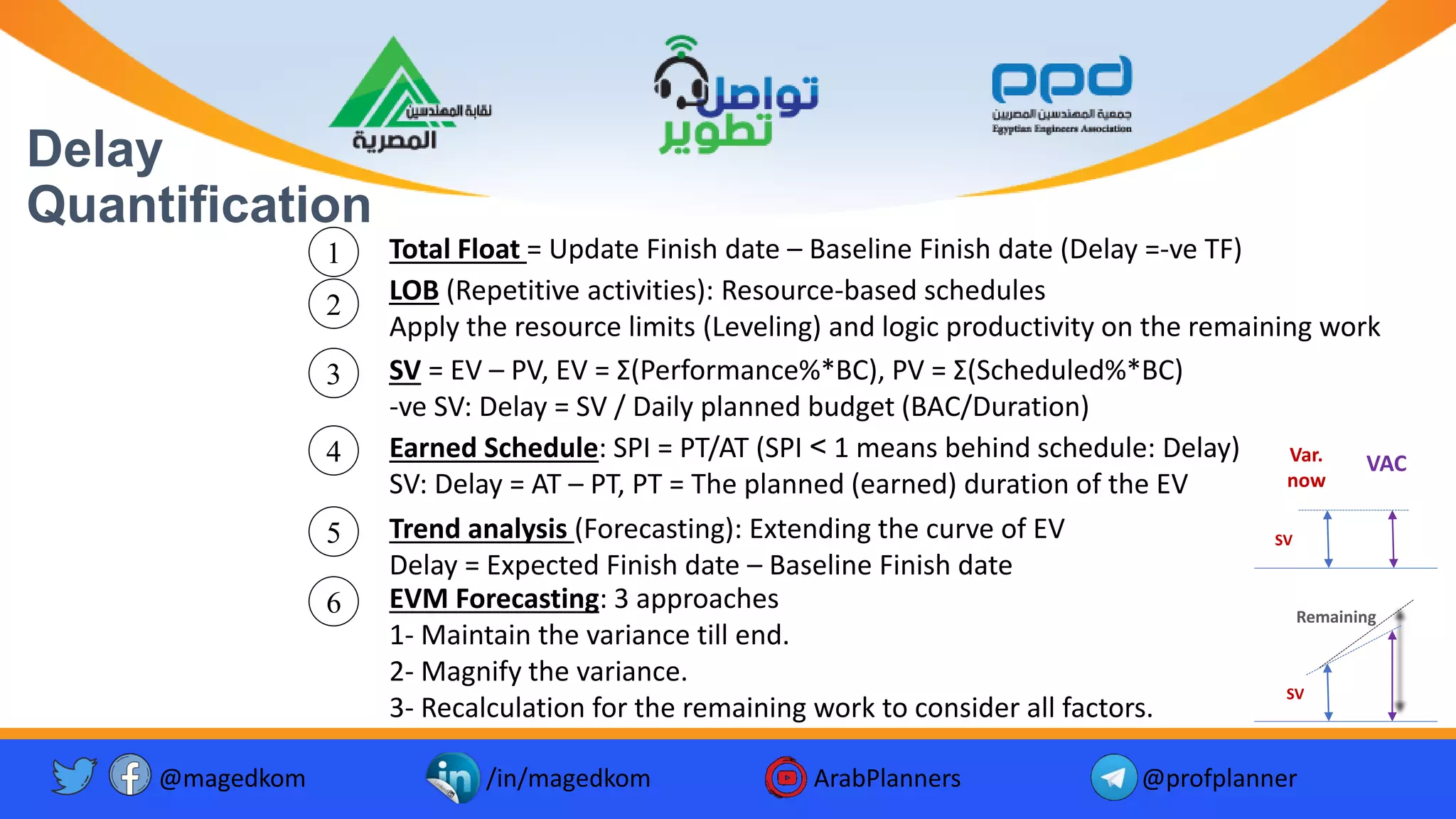

Delay
Quantification
1 Total Float = Update Finish date – Baseline Finish date (Delay =-ve TF)
3 SV = EV – PV, EV = Ʃ(Performance%*BC), PV = Ʃ(Scheduled%*BC)
-ve SV: Delay = SV / Daily planned budget (BAC/Duration)
4 Earned Schedule: SPI = PT/AT (SPI > 1 means behind schedule: Delay)
SV: Delay = AT – PT, PT = The planned (earned) duration of the EV
5 Trend analysis (Forecasting): Extending the curve of EV
Delay = Expected Finish date – Baseline Finish date
2
LOB (Repetitive activities): Resource-based schedules
Apply the resource limits (Leveling) and logic productivity on the remaining work
Var.
now
VAC
SV
Remaining
6 EVM Forecasting: 3 approaches
1- Maintain the variance till end.
2- Magnify the variance.
3- Recalculation for the remaining work to consider all factors.
SV
@magedkom /in/magedkom ArabPlanners @profplanner

Baseline (TF=0) Update TF=0 while
Performance%>Scheduled%
Data
Date
Data
Date
2- Line Of Balance
Data Date
Delay: 1W
Ahead:
4D
Dealy:
9D
29
29
(earned value)
(Invoices)
(planned value)
Cost baseline
3- SV= -1,067$
Daily
planned
budget=
266.67
$ / day
1- TF= -15 Days
5- Trend analysis
delay= -35 days
% Complete = 26.7%
= - 4 days
‫ععععع‬‫ع‬ ‫ععععع‬‫ع‬‫الجم‬
‫ا‬ ‫ععععععععع‬‫ع‬‫المؤش‬
‫المختلفة‬
...
ETC: time schedule update
4- ES, Var= -6 Days
‫صحته‬ ‫على‬ ‫تؤثر‬ ‫التي‬ ‫العوامل‬ ‫مناسبا‬ ‫يكون‬ ‫متى‬ ‫فائدته‬ ‫المؤشر‬
‫تعو‬ ‫ال‬ ‫جة‬ ‫ح‬ ‫غ‬ ‫أنشطة‬ ‫في‬ ‫تقدم‬ ‫وجود‬
‫ض‬
‫ك‬ ‫م‬ ‫ق‬ ‫أنشطة‬ ‫أو‬ ‫ج‬ ‫الح‬ ‫لمسا‬ ‫تأخ‬
‫ة‬
‫العكس‬ ‫أو‬ ‫ة‬ ‫صغ‬ ‫ذ‬ ‫تنف‬ ‫مدد‬ ‫تحتاج‬
‫قة‬ ‫السا‬ ‫األنشطة‬ ‫ه‬ ‫تشا‬ ‫عند‬
‫وال‬ ‫مة‬ ‫الق‬ ‫تكو‬ ‫ث‬ ‫ح‬ ‫والالحقة‬
‫مدة‬
‫ة‬ ‫د‬ ‫ط‬ ‫عالقة‬ ‫في‬
‫المخططة‬ ‫األعمال‬ ‫مة‬ ‫ق‬ ‫حساب‬
‫ة‬ ‫المكتس‬ ‫مة‬ ‫الق‬ ‫نتها‬ ‫ومقا‬
Schedule performance
index
‫ة‬ ‫المكتس‬ ‫مة‬ ‫الق‬ ‫مؤش‬
(SPI)
‫ا‬ ‫االخت‬ ‫العالقا‬ ‫م‬ ‫د‬ ‫العد‬ ‫وجود‬ ‫عند‬
‫ة‬
‫مطل‬ ‫تسلسل‬ ‫ة‬ ‫و‬ ‫الض‬ ‫تعكس‬ ‫ال‬ ‫التي‬
‫وب‬
‫األعمال‬ ‫ذ‬ ‫لتنف‬
‫معظم‬ ‫ط‬ ‫و‬ ‫منطقي‬ ‫كو‬ ‫عندما‬
‫إلزامي‬ ‫منطق‬ ‫العالقا‬
‫ؤخ‬ ‫قد‬ ‫والذي‬ ‫األطول‬ ‫المسا‬ ‫د‬ ‫تحد‬
‫ه‬ ‫تأخ‬ ‫عند‬ ‫وع‬ ‫المش‬
Critical path
‫ج‬ ‫الح‬ ‫المسا‬
‫عض‬ ‫على‬ ‫ة‬ ‫ا‬ ‫التك‬ ‫األنشطة‬ ‫اعتماد‬ ‫عدم‬
‫ها‬
‫المدخلة‬ ‫اإلنتاج‬ ‫معدال‬ ‫صحة‬ ‫عدم‬ ‫أو‬
‫ة‬ ‫ا‬ ‫التك‬ ‫األنشطة‬ ‫اعتماد‬ ‫عند‬
‫أح‬ ‫معدال‬ ‫وتأث‬ ‫عضها‬ ‫على‬
‫د‬
‫وع‬ ‫المش‬ ‫على‬ ‫األنشطة‬
‫ا‬ ‫التك‬ ‫األنشطة‬ ‫معدال‬ ‫ح‬ ‫توض‬
‫ة‬
‫نها‬ ‫ما‬ ‫ف‬ ‫واالتزا‬
Line of Balance
‫االتزا‬ ‫خط‬
‫واختالف‬ ‫ة‬ ‫ق‬ ‫المت‬ ‫األعمال‬ ‫ه‬ ‫تشا‬ ‫عدم‬
‫ة‬ ‫المطلو‬ ‫د‬ ‫والموا‬ ‫وف‬ ‫الظ‬
‫قة‬ ‫السا‬ ‫األنشطة‬ ‫ه‬ ‫تشا‬ ‫عند‬
‫األعمال‬ ‫تحتاج‬ ‫ث‬ ‫ح‬ ‫والالحقة‬
‫هة‬ ‫مشا‬ ‫لمدد‬ ‫ة‬ ‫ق‬ ‫المت‬
‫معدل‬ ‫متوسط‬ ‫ا‬ ‫استم‬ ‫أث‬ ‫ح‬ ‫توض‬
‫ق‬ ‫السا‬ ‫اإلنتاج‬
Trend analysis
‫االمتداد‬ ‫ل‬ ‫تحل‬
‫المسا‬ ‫م‬ ‫د‬ ‫العد‬ ‫تكدس‬ ‫حدوث‬ ‫عند‬
‫ا‬
‫ز‬ ‫حتاج‬ ‫ة‬ ‫ق‬ ‫المت‬ ‫المدة‬ ‫في‬ ‫واألنشطة‬
‫ادة‬
‫د‬ ‫الموا‬ ‫في‬ ‫ة‬ ‫ك‬
‫األنشط‬ ‫وعالقا‬ ‫ممد‬ ‫ة‬ ‫منطق‬ ‫عند‬
‫ة‬
‫ذها‬ ‫تنف‬ ‫ة‬ ‫وإمكان‬ ‫ة‬ ‫ق‬ ‫المت‬
‫د‬ ‫الموا‬
‫المتاحة‬
‫ا‬ ‫ومسا‬ ‫والعالقا‬ ‫المدد‬ ‫ح‬ ‫توض‬
‫وع‬ ‫المش‬ ‫أنشطة‬

Total float
‫الكلي‬ ‫الفائض‬

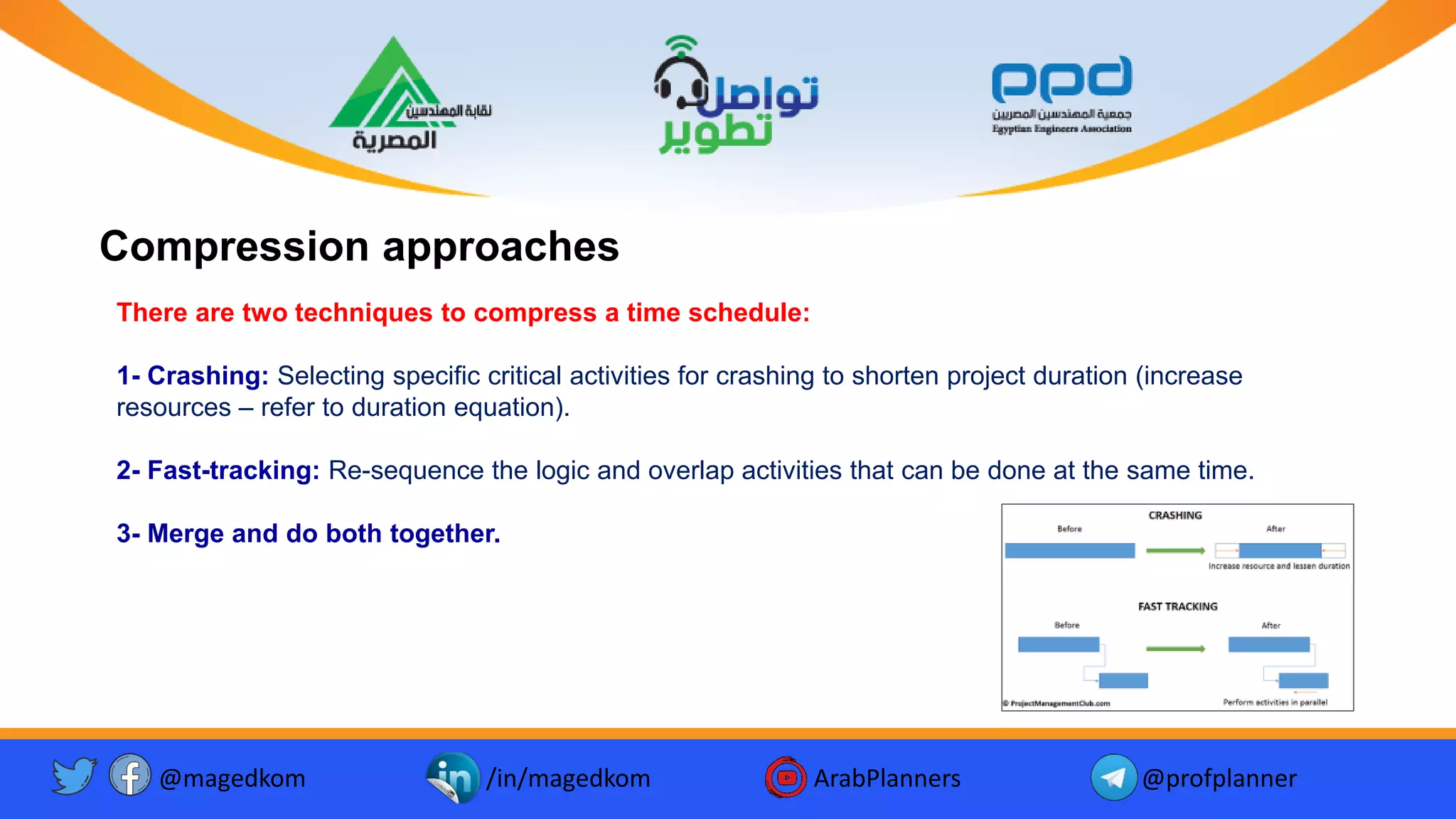

There are two techniques to compress a time schedule:
1- Crashing: Selecting specific critical activities for crashing to shorten project duration (increase
resources – refer to duration equation).
2- Fast-tracking: Re-sequence the logic and overlap activities that can be done at the same time.
3- Merge and do both together.
Compression approaches
@magedkom /in/magedkom ArabPlanners @profplanner

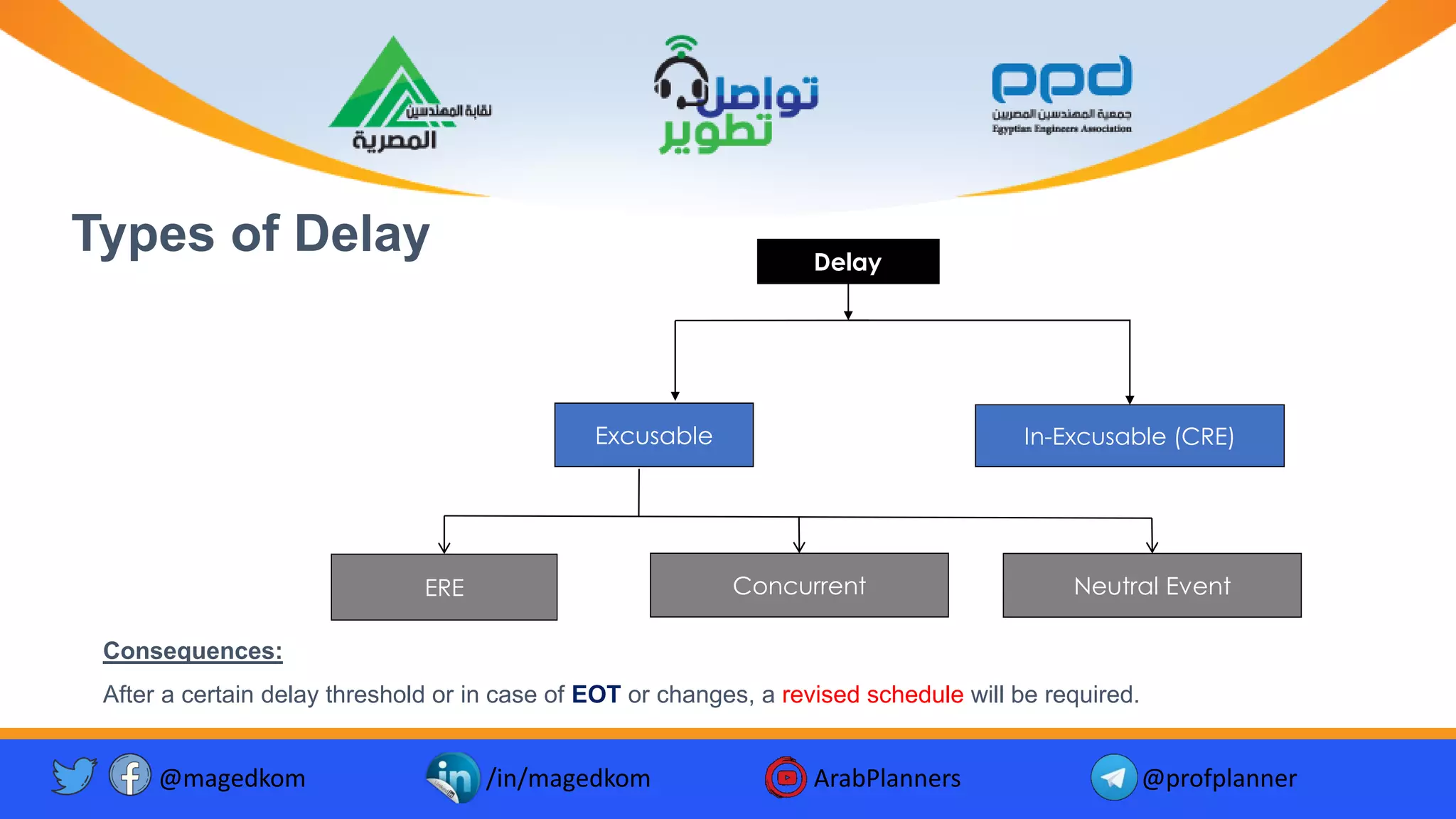

Types of Delay
Neutral Event
In-Excusable (CRE)
Excusable
ERE Concurrent
Delay
Consequences:
After a certain delay threshold or in case of EOT or changes, a revised schedule will be required.
@magedkom /in/magedkom ArabPlanners @profplanner
Cases of EOTs - SA ‫الحكومية‬ ‫والمشتريات‬ ‫المنافسات‬ ‫نظام‬
(
‫السعودي‬
)
‫والخمسون‬ ‫الحادية‬ ‫المادة‬
:
‫ئة‬ ‫طا‬ ‫وف‬ ‫ظ‬ ‫ع‬ ‫ا‬ً‫ج‬‫نات‬ ‫التأخ‬ ‫كا‬ ‫إذا‬ ‫ة‬ ‫المال‬ ‫ة‬ ‫وزا‬ ‫م‬ ‫المتعاقدة‬ ‫ة‬ ‫الحكوم‬ ‫الجهة‬ ‫اتفاق‬ ‫امة‬ ‫الغ‬ ‫م‬ ‫واإلعفاء‬ ‫العقد‬ ‫د‬ ‫تمد‬ ‫تم‬
(
Exceptional
events
)
‫المتعاقد‬ ‫ادة‬ ‫إ‬ ‫ع‬ ‫ج‬ ‫خا‬ ‫ب‬ ‫لس‬ ‫أو‬ ،
(
Out of control
)
‫اب‬ ‫األس‬ ‫هذه‬ ‫م‬ ‫التأخ‬ ‫مدة‬ ‫تتناسب‬ ‫أ‬ ‫ط‬ ‫ش‬ ،
.
‫والخمسون‬ ‫الثانية‬ ‫المادة‬
:
‫ة‬ ‫التال‬ ‫الحاال‬ ‫في‬ ‫العقد‬ ‫د‬ ‫تمد‬ ‫المستقلة‬ ‫ة‬ ‫الدائ‬ ‫س‬ ‫ئ‬ ‫أو‬ ‫المختص‬ ‫للوز‬
:
‫أ‬
-
‫العقد‬ ‫في‬ ‫د‬ ‫و‬ ‫ما‬ ‫على‬ ‫ة‬ ‫إضاف‬ ‫أعمال‬ ‫المتعاقد‬ ‫كلف‬ ‫إذا‬
(
Variation/ additional work
)
‫حجم‬ ‫م‬ ‫ة‬ ‫متناس‬ ‫المضافة‬ ‫المدة‬ ‫تكو‬ ‫أ‬ ‫ط‬ ‫ش‬ ،
‫ها‬ ‫ف‬ ‫التكل‬ ‫خ‬ ‫وتا‬ ‫عتها‬ ‫وط‬ ‫األعمال‬
.
‫ب‬
-
‫للمتعاقد‬ ‫تعود‬ ‫ال‬ ‫اب‬ ‫ألس‬ ‫عضها‬ ‫أو‬ ‫األعمال‬ ‫قاف‬ ‫إ‬ ‫ة‬ ‫الحكوم‬ ‫الجهة‬ ‫م‬ ‫أم‬ ‫صد‬ ‫إذا‬
(
Suspension
.)
-
‫المحدد‬ ‫الوق‬ ‫في‬ ‫العمل‬ ‫إلنجاز‬ ‫ة‬ ‫كاف‬ ‫غ‬ ‫وع‬ ‫للمش‬ ‫ة‬ ‫السنو‬ ‫ة‬ ‫المال‬ ‫االعتمادا‬ ‫كان‬ ‫إذا‬
(
Cash flow
.)
@magedkom /in/magedkom ArabPlanners @profplanner

EOT Claim Content ‫يلي‬ ‫ما‬ ‫الزمني‬ ‫للبرنامج‬ ‫يضاف‬ ‫الزمنية‬ ‫التمديدات‬ ‫حالة‬ ‫في‬
:
1
-
‫ة‬ ‫المطال‬ ‫هذه‬ ‫الى‬ ‫أد‬ ‫التي‬ ‫االحداث‬ ‫ف‬ ‫تع‬
2
-
‫م‬ ‫إلى‬ ‫ة‬ ‫االشا‬ ‫جة‬ ‫والنت‬ ‫األث‬ ‫ا‬ ‫ل‬ ‫ا‬ ‫المطال‬ ‫احداث‬ ‫د‬ ‫س‬
‫ستندا‬
‫فاقها‬ ‫وا‬ ‫ا‬ ‫االث‬
3
-
‫المتعل‬ ‫ة‬ ‫التعاقد‬ ‫اءا‬ ‫واالج‬ ‫نود‬ ‫ال‬ ‫م‬ ‫قة‬ ‫السا‬ ‫دا‬ ‫التمد‬
‫قة‬
‫المقاول‬ ‫ة‬ ‫وأحق‬ ‫الموضوع‬
4
-
‫ا‬ ‫امج‬ ‫ال‬ ‫م‬ ‫تقد‬ ‫في‬ ‫طلب‬ ‫ما‬ ‫شامل‬ ‫المعدل‬ ‫الزمني‬ ‫نامج‬ ‫ال‬
‫ة‬ ‫لزمن‬
‫األصلي‬ ‫ج‬ ‫الح‬ ‫المسا‬ ‫نة‬ ‫مقا‬ ‫م‬
5
-
‫الم‬ ‫د‬ ‫الجد‬ ‫التعاقدي‬ ‫ة‬ ‫النها‬ ‫خ‬ ‫وتا‬ ‫الزمني‬ ‫د‬ ‫التمد‬ ‫خالصة‬
‫طلوب‬
6
-
‫مها‬ ‫ق‬ ‫ت‬ ‫م‬ ‫د‬ ‫الس‬ ‫في‬ ‫ها‬ ‫ال‬ ‫ة‬ ‫االشا‬ ‫تم‬ ‫التي‬ ‫فقا‬ ‫الم‬
@magedkom /in/magedkom ArabPlanners @profplanner

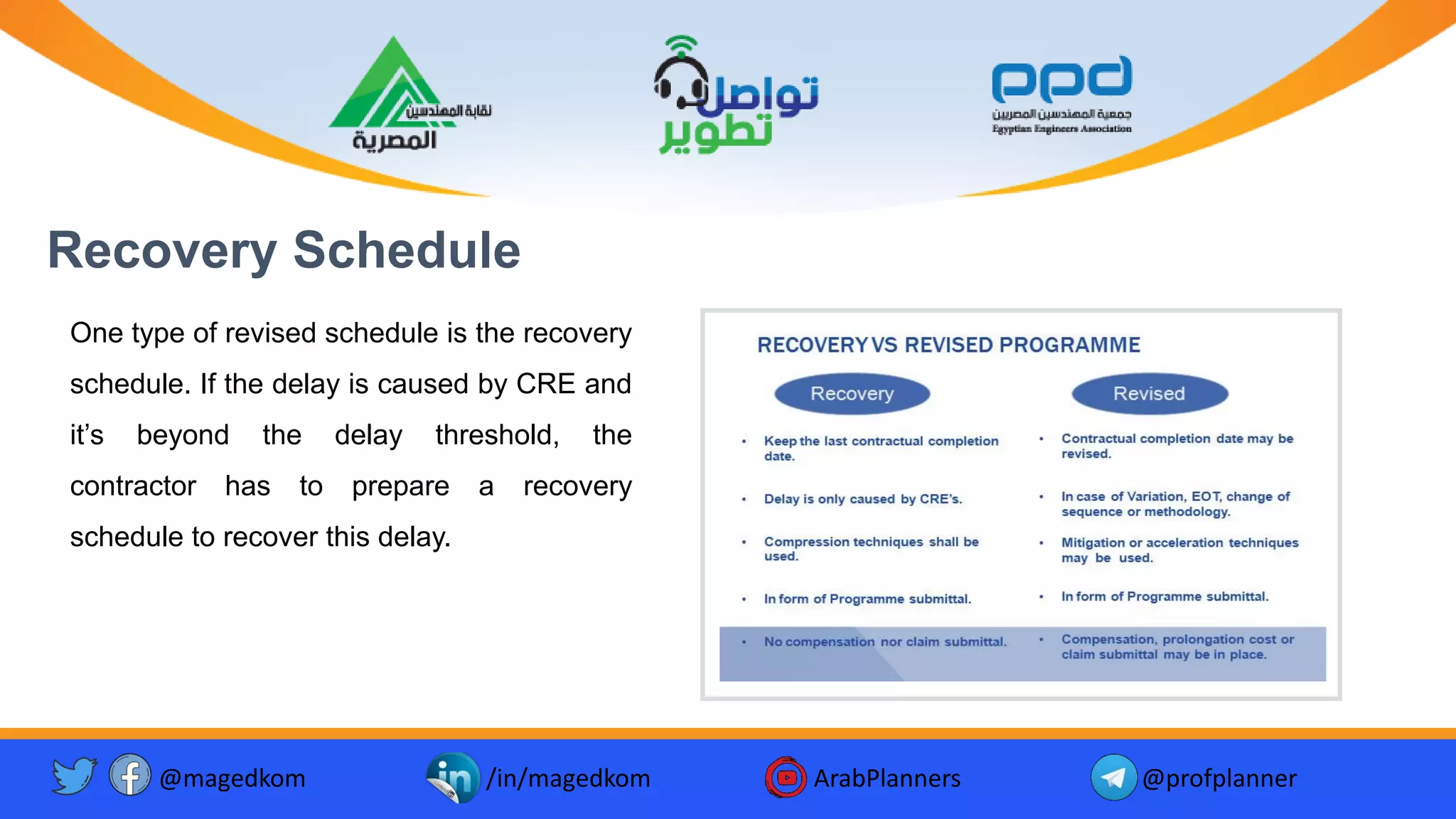

One type of revised schedule is the recovery
schedule. If the delay is caused by CRE and
it’s beyond the delay threshold, the
contractor has to prepare a recovery
schedule to recover this delay.
Recovery Schedule
@magedkom /in/magedkom ArabPlanners @profplanner

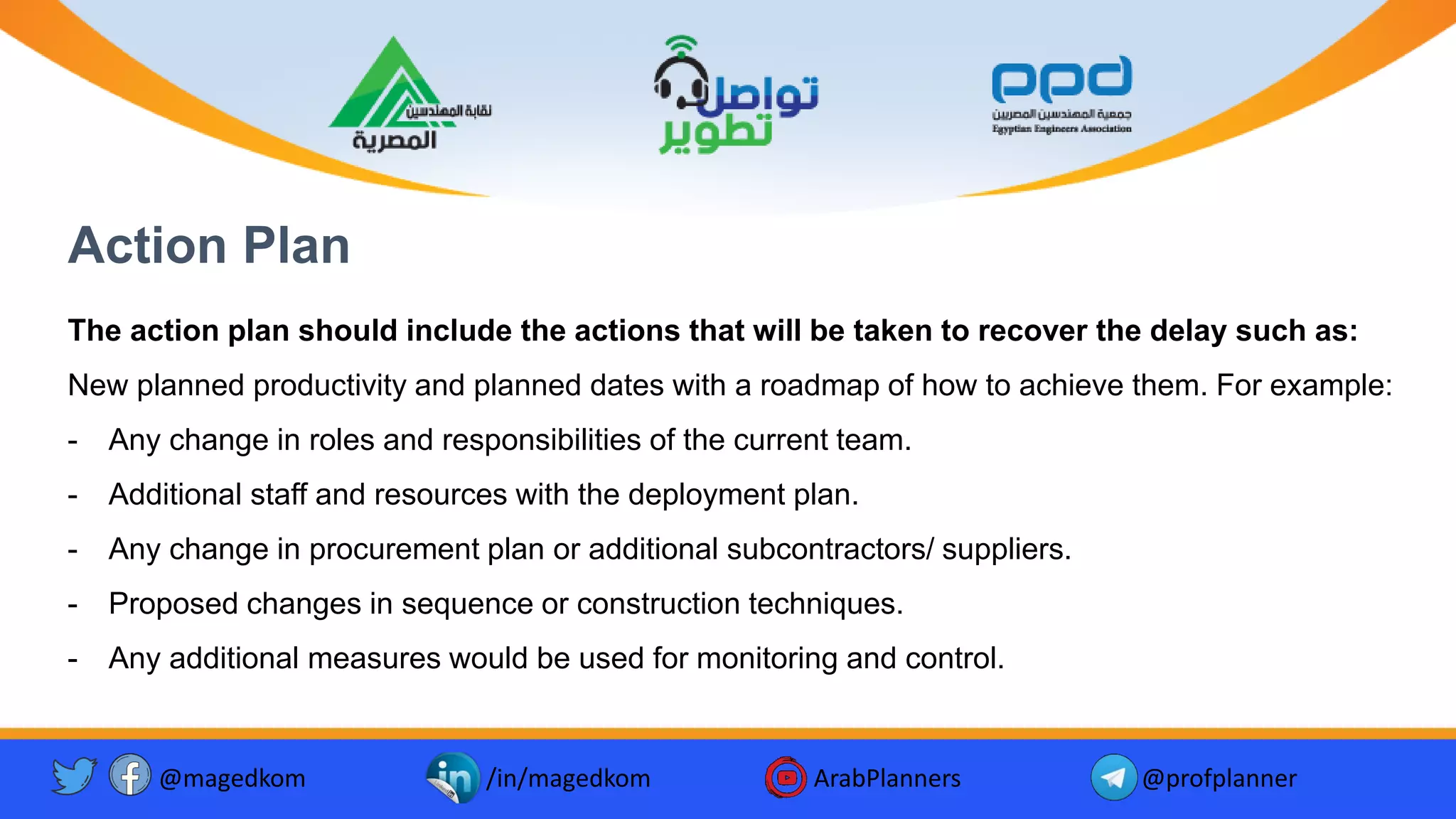

Action Plan
The action plan should include the actions that will be taken to recover the delay such as:
New planned productivity and planned dates with a roadmap of how to achieve them. For example:
- Any change in roles and responsibilities of the current team.
- Additional staff and resources with the deployment plan.
- Any change in procurement plan or additional subcontractors/ suppliers.
- Proposed changes in sequence or construction techniques.
- Any additional measures would be used for monitoring and control.
@magedkom /in/magedkom ArabPlanners @profplanner
Recap
1. Planning and scheduling (Project management - Planning and control)
2. Time schedule development (WBS, Activity list/dur.s, Relationships & CPM)
3. Resource and cost loading (Resources histograms and cash flow)
4. Time schedule submittal (Assumptions and deliverables)
5. Review and approval (Technical and contractual review - Baseline)
6. Update and reporting (Collecting data, checks & levels of reporting)
7. Delay quantification approaches (TF, LOB, SV, ES, Trend analysis & Forecasting)
8. Mitigation and action plans (Types of delay, EOT cases, Revised & recovery schedule)
@magedkom /in/magedkom ArabPlanners @profplanner
Related Lectures and Courses
Course at Luqman Academy YouTube Lectures
38
‫نشرته‬ ‫ما‬ ‫آخر‬
‫حديثا‬
‫في‬ ‫متكاملة‬ ‫دورة‬
‫التأخير‬ ‫تحليل‬
‫باستخ‬
‫أبرز‬ ‫دام‬
‫من‬ ‫الصادرة‬ ‫المراجع‬
AACE, SCL,
RICS, ASCE
‫الفني‬ ‫المصادر‬ ‫من‬ ‫والعديد‬
‫ة‬
‫والقانونية‬
...
‫مع‬
‫الخاصة‬ ‫الحاالت‬ ‫مناقشة‬
‫تشمل‬ ‫كما‬ ،‫وآثارها‬ ‫معالجته‬ ‫وطرق‬ ‫للتأخير‬
‫تقديم‬ ‫لكيفية‬ ‫توضيح‬ ‫الدورة‬
‫مطالب‬
‫ات‬
‫ا‬
‫لتمديد‬
‫لها‬ ‫عملي‬ ‫ومثال‬ ‫ومكوناتها‬ ‫المشروع‬ ‫لمدة‬
.
Thank You
Don’t Hesitate to contact….
M.Maged
magedkom@gmail.com
mobile : 00966-580264968

More Related Content

What's hot

خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الثاني
خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الثاني خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الثاني
خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الثاني
M Maged Hegazy, LLM, MBA, CCP, P3O

50 Planning Fundamentals V5.0 - procedures only
50 Planning Fundamentals V5.0 - procedures only50 Planning Fundamentals V5.0 - procedures only
50 Planning Fundamentals V5.0 - procedures only
M Maged Hegazy, LLM, MBA, CCP, P3O

Time Impact Analysis
Time Impact AnalysisTime Impact Analysis
Time Impact Analysis
Chris Carson

Update Delay Analysis
Update Delay AnalysisUpdate Delay Analysis
Update Delay Analysis
Chris Carson

Extension of time (E.O.T) By Ahmed Ibarhim
Extension of time (E.O.T) By Ahmed IbarhimExtension of time (E.O.T) By Ahmed Ibarhim
Extension of time (E.O.T) By Ahmed Ibarhim
Ahmed Al-Senosy Ph.D(cand),MSc,PMP,RMP

Avoiding unrealistic schedules
Avoiding unrealistic schedulesAvoiding unrealistic schedules
Avoiding unrealistic schedules
Hatem Hegazi

Delay analysis ... wise after the event.
Delay analysis ... wise after the event.Delay analysis ... wise after the event.
Delay analysis ... wise after the event.
Tim Lloyd

Project management using Primavera 6.x by Karim Ragab
Project management using Primavera 6.x by Karim RagabProject management using Primavera 6.x by Karim Ragab
Project management using Primavera 6.x by Karim Ragab
Karim Ragab

Schedule Updates
Schedule UpdatesSchedule Updates
Schedule Updates
Chris Carson

Earned Value Management - Leading & Misleading in Project Control
Earned Value Management - Leading & Misleading in Project ControlEarned Value Management - Leading & Misleading in Project Control
Earned Value Management - Leading & Misleading in Project Control
M Maged Hegazy, LLM, MBA, CCP, P3O

Project Controls Expo 09 Nov 2011, London - DELAY AND FORENSIC ANALYSIS By Ro...
Project Controls Expo 09 Nov 2011, London - DELAY AND FORENSIC ANALYSIS By Ro...Project Controls Expo 09 Nov 2011, London - DELAY AND FORENSIC ANALYSIS By Ro...
Project Controls Expo 09 Nov 2011, London - DELAY AND FORENSIC ANALYSIS By Ro...
Project Controls Expo

Session W2 - Delay Claims and Analysis Based on FIDIC Forms of Contract
Session W2 - Delay Claims and Analysis Based on FIDIC Forms of ContractSession W2 - Delay Claims and Analysis Based on FIDIC Forms of Contract
Session W2 - Delay Claims and Analysis Based on FIDIC Forms of Contract
Project Controls Expo

Forensic schedule analysis acesss
Forensic schedule analysis acesssForensic schedule analysis acesss
Forensic schedule analysis acesss
McLachlan Lister Pty Limited

Baseline schedule review and analysis
Baseline schedule review and analysisBaseline schedule review and analysis
Baseline schedule review and analysis
ADITYA GHUMARE

CCP Technical Paper and Application
CCP Technical Paper and ApplicationCCP Technical Paper and Application
CCP Technical Paper and Application
M Maged Hegazy, LLM, MBA, CCP, P3O

50 qts مقابلة عمل planning
50 qts مقابلة عمل planning50 qts مقابلة عمل planning
50 qts مقابلة عمل planning
M Maged Hegazy, LLM, MBA, CCP, P3O

Fundamentals of Construction Contracts - English, ver. 2021
Fundamentals of Construction Contracts - English, ver. 2021Fundamentals of Construction Contracts - English, ver. 2021
Fundamentals of Construction Contracts - English, ver. 2021
M Maged Hegazy, LLM, MBA, CCP, P3O

Construction Delay Analysis, Simplified
Construction Delay Analysis, SimplifiedConstruction Delay Analysis, Simplified
Construction Delay Analysis, Simplified
Michael Pink

Quantify Construction Damages related to Delay, disruption, and inefficiencies
Quantify Construction Damages related to Delay, disruption, and inefficienciesQuantify Construction Damages related to Delay, disruption, and inefficiencies
Quantify Construction Damages related to Delay, disruption, and inefficiencies
Michael Pink

Microsoft project 2010 by Karim Ragab
Microsoft project 2010 by Karim RagabMicrosoft project 2010 by Karim Ragab
Microsoft project 2010 by Karim Ragab
Karim Ragab

What's hot (20)

خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الثاني
خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الثاني خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الثاني
خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الثاني

50 Planning Fundamentals V5.0 - procedures only
50 Planning Fundamentals V5.0 - procedures only50 Planning Fundamentals V5.0 - procedures only
50 Planning Fundamentals V5.0 - procedures only

Time Impact Analysis
Time Impact AnalysisTime Impact Analysis
Time Impact Analysis

Update Delay Analysis
Update Delay AnalysisUpdate Delay Analysis
Update Delay Analysis

Extension of time (E.O.T) By Ahmed Ibarhim
Extension of time (E.O.T) By Ahmed IbarhimExtension of time (E.O.T) By Ahmed Ibarhim
Extension of time (E.O.T) By Ahmed Ibarhim

Avoiding unrealistic schedules
Avoiding unrealistic schedulesAvoiding unrealistic schedules
Avoiding unrealistic schedules

Delay analysis ... wise after the event.
Delay analysis ... wise after the event.Delay analysis ... wise after the event.
Delay analysis ... wise after the event.

Project management using Primavera 6.x by Karim Ragab
Project management using Primavera 6.x by Karim RagabProject management using Primavera 6.x by Karim Ragab
Project management using Primavera 6.x by Karim Ragab

Schedule Updates
Schedule UpdatesSchedule Updates
Schedule Updates

Earned Value Management - Leading & Misleading in Project Control
Earned Value Management - Leading & Misleading in Project ControlEarned Value Management - Leading & Misleading in Project Control
Earned Value Management - Leading & Misleading in Project Control

Project Controls Expo 09 Nov 2011, London - DELAY AND FORENSIC ANALYSIS By Ro...
Project Controls Expo 09 Nov 2011, London - DELAY AND FORENSIC ANALYSIS By Ro...Project Controls Expo 09 Nov 2011, London - DELAY AND FORENSIC ANALYSIS By Ro...
Project Controls Expo 09 Nov 2011, London - DELAY AND FORENSIC ANALYSIS By Ro...

Session W2 - Delay Claims and Analysis Based on FIDIC Forms of Contract
Session W2 - Delay Claims and Analysis Based on FIDIC Forms of ContractSession W2 - Delay Claims and Analysis Based on FIDIC Forms of Contract
Session W2 - Delay Claims and Analysis Based on FIDIC Forms of Contract

Forensic schedule analysis acesss
Forensic schedule analysis acesssForensic schedule analysis acesss
Forensic schedule analysis acesss

Baseline schedule review and analysis
Baseline schedule review and analysisBaseline schedule review and analysis
Baseline schedule review and analysis

CCP Technical Paper and Application
CCP Technical Paper and ApplicationCCP Technical Paper and Application
CCP Technical Paper and Application

50 qts مقابلة عمل planning
50 qts مقابلة عمل planning50 qts مقابلة عمل planning
50 qts مقابلة عمل planning

Fundamentals of Construction Contracts - English, ver. 2021
Fundamentals of Construction Contracts - English, ver. 2021Fundamentals of Construction Contracts - English, ver. 2021
Fundamentals of Construction Contracts - English, ver. 2021

Construction Delay Analysis, Simplified
Construction Delay Analysis, SimplifiedConstruction Delay Analysis, Simplified
Construction Delay Analysis, Simplified

Quantify Construction Damages related to Delay, disruption, and inefficiencies
Quantify Construction Damages related to Delay, disruption, and inefficienciesQuantify Construction Damages related to Delay, disruption, and inefficiencies
Quantify Construction Damages related to Delay, disruption, and inefficiencies

Microsoft project 2010 by Karim Ragab
Microsoft project 2010 by Karim RagabMicrosoft project 2010 by Karim Ragab
Microsoft project 2010 by Karim Ragab

Similar to Project Schedule Management

139 مبادرة #تواصل_تطوير المحاضرة ال 139 من المبادرة مهندس / محمد ماجد استشاري...
139 مبادرة #تواصل_تطوير المحاضرة ال 139 من المبادرة مهندس / محمد ماجد استشاري...139 مبادرة #تواصل_تطوير المحاضرة ال 139 من المبادرة مهندس / محمد ماجد استشاري...
139 مبادرة #تواصل_تطوير المحاضرة ال 139 من المبادرة مهندس / محمد ماجد استشاري...
Egyptian Engineers Association

ayed cv.newest one 23.11.2011
ayed cv.newest one 23.11.2011ayed cv.newest one 23.11.2011
ayed cv.newest one 23.11.2011
Iyad Hassan

Program Mgmt Framework
Program Mgmt FrameworkProgram Mgmt Framework
Program Mgmt Framework
Rupali Das , MBA, PMP

Peter White CV - Latest
Peter White CV - LatestPeter White CV - Latest
Peter White CV - Latest
Peter White

AYESA Presentation - GC East Coast Railway_12th January.pdf
AYESA Presentation - GC East Coast Railway_12th January.pdfAYESA Presentation - GC East Coast Railway_12th January.pdf
AYESA Presentation - GC East Coast Railway_12th January.pdf
rinkumandaljis

Punch List Coordinator - (ICAPS Specialist) Onshore/Offshore
Punch List Coordinator - (ICAPS Specialist)  Onshore/OffshorePunch List Coordinator - (ICAPS Specialist)  Onshore/Offshore
Punch List Coordinator - (ICAPS Specialist) Onshore/Offshore
Renold Pereira

Epm dimensys introductie gvk
Epm dimensys introductie gvkEpm dimensys introductie gvk
Epm dimensys introductie gvk
Glenn Van_kooijk

Peter White CV
Peter White CV Peter White CV
Peter White CV
Peter White

projectmanagement-123765482.pdf
projectmanagement-123765482.pdfprojectmanagement-123765482.pdf
projectmanagement-123765482.pdf
AmarDeo7

ERP II Overview.ppt
ERP II Overview.pptERP II Overview.ppt
ERP II Overview.ppt
FirasAlhilu

Performance Measurement and Weightage Systems
Performance Measurement and Weightage SystemsPerformance Measurement and Weightage Systems
Performance Measurement and Weightage Systems
M Maged Hegazy, LLM, MBA, CCP, P3O

المحاضرة رقم 208 مهندس / محمد ماجد حجازي عنوان المحاضرة Performance Measur...
 المحاضرة رقم 208 مهندس / محمد ماجد حجازي  عنوان المحاضرة  Performance Measur... المحاضرة رقم 208 مهندس / محمد ماجد حجازي  عنوان المحاضرة  Performance Measur...
المحاضرة رقم 208 مهندس / محمد ماجد حجازي عنوان المحاضرة Performance Measur...
Egyptian Engineers Association

2. project initiation
2. project initiation2. project initiation
2. project initiation
Mad Jutt

Project Management - principles, practice and process
Project Management - principles, practice and process Project Management - principles, practice and process
Project Management - principles, practice and process
Charles Cotter, PhD

BCA resume - Admin Cum Doc Cont (red1)
BCA resume - Admin Cum Doc Cont (red1)BCA resume - Admin Cum Doc Cont (red1)
BCA resume - Admin Cum Doc Cont (red1)
Benjan Amtipuesto

Intro to PM.ppt
Intro to PM.pptIntro to PM.ppt
Intro to PM.ppt
Chandrabhan Seniya

CompTIA Project+ Objectives
CompTIA Project+ ObjectivesCompTIA Project+ Objectives
CompTIA Project+ Objectives
sombat nirund

Mitigation And Performance Recovery Using Earned Value
Mitigation And Performance Recovery Using Earned ValueMitigation And Performance Recovery Using Earned Value
Mitigation And Performance Recovery Using Earned Value
Chris Carson

Schedule Recovery Using Earned Value
Schedule Recovery Using Earned ValueSchedule Recovery Using Earned Value
Schedule Recovery Using Earned Value
Chris Carson

Project management
Project managementProject management
Project management
twilight89

Similar to Project Schedule Management (20)

139 مبادرة #تواصل_تطوير المحاضرة ال 139 من المبادرة مهندس / محمد ماجد استشاري...
139 مبادرة #تواصل_تطوير المحاضرة ال 139 من المبادرة مهندس / محمد ماجد استشاري...139 مبادرة #تواصل_تطوير المحاضرة ال 139 من المبادرة مهندس / محمد ماجد استشاري...
139 مبادرة #تواصل_تطوير المحاضرة ال 139 من المبادرة مهندس / محمد ماجد استشاري...

ayed cv.newest one 23.11.2011
ayed cv.newest one 23.11.2011ayed cv.newest one 23.11.2011
ayed cv.newest one 23.11.2011

Program Mgmt Framework
Program Mgmt FrameworkProgram Mgmt Framework
Program Mgmt Framework

Peter White CV - Latest
Peter White CV - LatestPeter White CV - Latest
Peter White CV - Latest

AYESA Presentation - GC East Coast Railway_12th January.pdf
AYESA Presentation - GC East Coast Railway_12th January.pdfAYESA Presentation - GC East Coast Railway_12th January.pdf
AYESA Presentation - GC East Coast Railway_12th January.pdf

Punch List Coordinator - (ICAPS Specialist) Onshore/Offshore
Punch List Coordinator - (ICAPS Specialist)  Onshore/OffshorePunch List Coordinator - (ICAPS Specialist)  Onshore/Offshore
Punch List Coordinator - (ICAPS Specialist) Onshore/Offshore

Epm dimensys introductie gvk
Epm dimensys introductie gvkEpm dimensys introductie gvk
Epm dimensys introductie gvk

Peter White CV
Peter White CV Peter White CV
Peter White CV

projectmanagement-123765482.pdf
projectmanagement-123765482.pdfprojectmanagement-123765482.pdf
projectmanagement-123765482.pdf

ERP II Overview.ppt
ERP II Overview.pptERP II Overview.ppt
ERP II Overview.ppt

Performance Measurement and Weightage Systems
Performance Measurement and Weightage SystemsPerformance Measurement and Weightage Systems
Performance Measurement and Weightage Systems

المحاضرة رقم 208 مهندس / محمد ماجد حجازي عنوان المحاضرة Performance Measur...
 المحاضرة رقم 208 مهندس / محمد ماجد حجازي  عنوان المحاضرة  Performance Measur... المحاضرة رقم 208 مهندس / محمد ماجد حجازي  عنوان المحاضرة  Performance Measur...
المحاضرة رقم 208 مهندس / محمد ماجد حجازي عنوان المحاضرة Performance Measur...

2. project initiation
2. project initiation2. project initiation
2. project initiation

Project Management - principles, practice and process
Project Management - principles, practice and process Project Management - principles, practice and process
Project Management - principles, practice and process

BCA resume - Admin Cum Doc Cont (red1)
BCA resume - Admin Cum Doc Cont (red1)BCA resume - Admin Cum Doc Cont (red1)
BCA resume - Admin Cum Doc Cont (red1)

Intro to PM.ppt
Intro to PM.pptIntro to PM.ppt
Intro to PM.ppt

CompTIA Project+ Objectives
CompTIA Project+ ObjectivesCompTIA Project+ Objectives
CompTIA Project+ Objectives

Mitigation And Performance Recovery Using Earned Value
Mitigation And Performance Recovery Using Earned ValueMitigation And Performance Recovery Using Earned Value
Mitigation And Performance Recovery Using Earned Value

Schedule Recovery Using Earned Value
Schedule Recovery Using Earned ValueSchedule Recovery Using Earned Value
Schedule Recovery Using Earned Value

Project management
Project managementProject management
Project management

More from M Maged Hegazy, LLM, MBA, CCP, P3O

Variation Orders – Types, Permission and Consequences
Variation Orders – Types, Permission and ConsequencesVariation Orders – Types, Permission and Consequences
Variation Orders – Types, Permission and Consequences
M Maged Hegazy, LLM, MBA, CCP, P3O

Roadmap to Membership of RICS - Pathways and Routes
Roadmap to Membership of RICS - Pathways and RoutesRoadmap to Membership of RICS - Pathways and Routes
Roadmap to Membership of RICS - Pathways and Routes
M Maged Hegazy, LLM, MBA, CCP, P3O

Concurrent Delay in Construction
Concurrent Delay in ConstructionConcurrent Delay in Construction
Concurrent Delay in Construction
M Maged Hegazy, LLM, MBA, CCP, P3O

Essentials of EOT Claims
Essentials of EOT ClaimsEssentials of EOT Claims
Essentials of EOT Claims
M Maged Hegazy, LLM, MBA, CCP, P3O

CCP Course - Introduction.pdf
CCP Course - Introduction.pdfCCP Course - Introduction.pdf
CCP Course - Introduction.pdf
M Maged Hegazy, LLM, MBA, CCP, P3O

International Delay Analysis Approaches
International Delay Analysis ApproachesInternational Delay Analysis Approaches
International Delay Analysis Approaches
M Maged Hegazy, LLM, MBA, CCP, P3O

Missing and modern necessary skills
Missing and modern necessary skillsMissing and modern necessary skills
Missing and modern necessary skills
M Maged Hegazy, LLM, MBA, CCP, P3O

Standard Forms of Construction Contracts
Standard Forms of Construction ContractsStandard Forms of Construction Contracts
Standard Forms of Construction Contracts
M Maged Hegazy, LLM, MBA, CCP, P3O

Introduction to construction contracts fundamentals
Introduction to construction contracts fundamentalsIntroduction to construction contracts fundamentals
Introduction to construction contracts fundamentals
M Maged Hegazy, LLM, MBA, CCP, P3O

خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الأول
خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الأولخمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الأول
خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الأول
M Maged Hegazy, LLM, MBA, CCP, P3O

Procurement negotiation tips and phases
Procurement negotiation tips and phasesProcurement negotiation tips and phases
Procurement negotiation tips and phases
M Maged Hegazy, LLM, MBA, CCP, P3O

5th Anniversary of Planning & Project Control Group
5th Anniversary of Planning & Project Control Group5th Anniversary of Planning & Project Control Group
5th Anniversary of Planning & Project Control Group
M Maged Hegazy, LLM, MBA, CCP, P3O

26 مؤتمر ادارة المشروعات contract relations management
26 مؤتمر ادارة المشروعات contract relations management26 مؤتمر ادارة المشروعات contract relations management
26 مؤتمر ادارة المشروعات contract relations management
M Maged Hegazy, LLM, MBA, CCP, P3O

4 أعوام الصفحة الرئيسية التابع لها جروبات Best Advice
4 أعوام الصفحة الرئيسية التابع لها جروبات Best Advice4 أعوام الصفحة الرئيسية التابع لها جروبات Best Advice
4 أعوام الصفحة الرئيسية التابع لها جروبات Best Advice
M Maged Hegazy, LLM, MBA, CCP, P3O

Contracts classification
Contracts classificationContracts classification
Contracts classification
M Maged Hegazy, LLM, MBA, CCP, P3O

3 years acheivements
3 years acheivements3 years acheivements
PMP integration review
PMP integration reviewPMP integration review
PMP integration review
M Maged Hegazy, LLM, MBA, CCP, P3O

Pmp procurement rev
Pmp procurement revPmp procurement rev

More from M Maged Hegazy, LLM, MBA, CCP, P3O (18)

Variation Orders – Types, Permission and Consequences
Variation Orders – Types, Permission and ConsequencesVariation Orders – Types, Permission and Consequences
Variation Orders – Types, Permission and Consequences

Roadmap to Membership of RICS - Pathways and Routes
Roadmap to Membership of RICS - Pathways and RoutesRoadmap to Membership of RICS - Pathways and Routes
Roadmap to Membership of RICS - Pathways and Routes

Concurrent Delay in Construction
Concurrent Delay in ConstructionConcurrent Delay in Construction
Concurrent Delay in Construction

Essentials of EOT Claims
Essentials of EOT ClaimsEssentials of EOT Claims
Essentials of EOT Claims

CCP Course - Introduction.pdf
CCP Course - Introduction.pdfCCP Course - Introduction.pdf
CCP Course - Introduction.pdf

International Delay Analysis Approaches
International Delay Analysis ApproachesInternational Delay Analysis Approaches
International Delay Analysis Approaches

Missing and modern necessary skills
Missing and modern necessary skillsMissing and modern necessary skills
Missing and modern necessary skills

Standard Forms of Construction Contracts
Standard Forms of Construction ContractsStandard Forms of Construction Contracts
Standard Forms of Construction Contracts

Introduction to construction contracts fundamentals
Introduction to construction contracts fundamentalsIntroduction to construction contracts fundamentals
Introduction to construction contracts fundamentals

خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الأول
خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الأولخمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الأول
خمسون سؤال في إدارة عقود التشييد أو المقاولات -الإصدار الأول

Procurement negotiation tips and phases
Procurement negotiation tips and phasesProcurement negotiation tips and phases
Procurement negotiation tips and phases

5th Anniversary of Planning & Project Control Group
5th Anniversary of Planning & Project Control Group5th Anniversary of Planning & Project Control Group
5th Anniversary of Planning & Project Control Group

26 مؤتمر ادارة المشروعات contract relations management
26 مؤتمر ادارة المشروعات contract relations management26 مؤتمر ادارة المشروعات contract relations management
26 مؤتمر ادارة المشروعات contract relations management

4 أعوام الصفحة الرئيسية التابع لها جروبات Best Advice
4 أعوام الصفحة الرئيسية التابع لها جروبات Best Advice4 أعوام الصفحة الرئيسية التابع لها جروبات Best Advice
4 أعوام الصفحة الرئيسية التابع لها جروبات Best Advice

Contracts classification
Contracts classificationContracts classification
Contracts classification

3 years acheivements
3 years acheivements3 years acheivements
3 years acheivements

PMP integration review
PMP integration reviewPMP integration review
PMP integration review

Pmp procurement rev
Pmp procurement revPmp procurement rev
Pmp procurement rev

Recently uploaded

132/33KV substation case study Presentation
132/33KV substation case study Presentation132/33KV substation case study Presentation
132/33KV substation case study Presentation
kandramariana6

Generative AI leverages algorithms to create various forms of content
Generative AI leverages algorithms to create various forms of contentGenerative AI leverages algorithms to create various forms of content
Generative AI leverages algorithms to create various forms of content
Hitesh Mohapatra

Software Engineering and Project Management - Introduction, Modeling Concepts...
Software Engineering and Project Management - Introduction, Modeling Concepts...Software Engineering and Project Management - Introduction, Modeling Concepts...
Software Engineering and Project Management - Introduction, Modeling Concepts...
Prakhyath Rai

Null Bangalore | Pentesters Approach to AWS IAM
Null Bangalore | Pentesters Approach to AWS IAMNull Bangalore | Pentesters Approach to AWS IAM
Null Bangalore | Pentesters Approach to AWS IAM
Divyanshu

LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by AnantLLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
Anant Corporation

Data Control Language.pptx Data Control Language.pptx
Data Control Language.pptx Data Control Language.pptxData Control Language.pptx Data Control Language.pptx
Data Control Language.pptx Data Control Language.pptx
ramrag33

Comparative analysis between traditional aquaponics and reconstructed aquapon...
Comparative analysis between traditional aquaponics and reconstructed aquapon...Comparative analysis between traditional aquaponics and reconstructed aquapon...
Comparative analysis between traditional aquaponics and reconstructed aquapon...
bijceesjournal

Embedded machine learning-based road conditions and driving behavior monitoring
Embedded machine learning-based road conditions and driving behavior monitoringEmbedded machine learning-based road conditions and driving behavior monitoring
Embedded machine learning-based road conditions and driving behavior monitoring
IJECEIAES

Certificates - Mahmoud Mohamed Moursi Ahmed
Certificates - Mahmoud Mohamed Moursi AhmedCertificates - Mahmoud Mohamed Moursi Ahmed
Certificates - Mahmoud Mohamed Moursi Ahmed
Mahmoud Morsy

Rainfall intensity duration frequency curve statistical analysis and modeling...
Rainfall intensity duration frequency curve statistical analysis and modeling...Rainfall intensity duration frequency curve statistical analysis and modeling...
Rainfall intensity duration frequency curve statistical analysis and modeling...
bijceesjournal

People as resource Grade IX.pdf minimala
People as resource Grade IX.pdf minimalaPeople as resource Grade IX.pdf minimala
People as resource Grade IX.pdf minimala
riddhimaagrawal986

BRAIN TUMOR DETECTION for seminar ppt.pdf
BRAIN TUMOR DETECTION for seminar ppt.pdfBRAIN TUMOR DETECTION for seminar ppt.pdf
BRAIN TUMOR DETECTION for seminar ppt.pdf
LAXMAREDDY22

学校原版美国波士顿大学毕业证学历学位证书原版一模一样
学校原版美国波士顿大学毕业证学历学位证书原版一模一样学校原版美国波士顿大学毕业证学历学位证书原版一模一样
学校原版美国波士顿大学毕业证学历学位证书原版一模一样
171ticu

cnn.pptx Convolutional neural network used for image classication
cnn.pptx Convolutional neural network used for image classicationcnn.pptx Convolutional neural network used for image classication
cnn.pptx Convolutional neural network used for image classication
SakkaravarthiShanmug

Applications of artificial Intelligence in Mechanical Engineering.pdf
Applications of artificial Intelligence in Mechanical Engineering.pdfApplications of artificial Intelligence in Mechanical Engineering.pdf
Applications of artificial Intelligence in Mechanical Engineering.pdf
Atif Razi

An improved modulation technique suitable for a three level flying capacitor ...
An improved modulation technique suitable for a three level flying capacitor ...An improved modulation technique suitable for a three level flying capacitor ...
An improved modulation technique suitable for a three level flying capacitor ...
IJECEIAES

Manufacturing Process of molasses based distillery ppt.pptx
Manufacturing Process of molasses based distillery ppt.pptxManufacturing Process of molasses based distillery ppt.pptx
Manufacturing Process of molasses based distillery ppt.pptx
Madan Karki

Seminar on Distillation study-mafia.pptx
Seminar on Distillation study-mafia.pptxSeminar on Distillation study-mafia.pptx
Seminar on Distillation study-mafia.pptx
Madan Karki

Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
shadow0702a

spirit beverages ppt without graphics.pptx
spirit beverages ppt without graphics.pptxspirit beverages ppt without graphics.pptx
spirit beverages ppt without graphics.pptx
Madan Karki

Recently uploaded (20)

132/33KV substation case study Presentation
132/33KV substation case study Presentation132/33KV substation case study Presentation
132/33KV substation case study Presentation

Generative AI leverages algorithms to create various forms of content
Generative AI leverages algorithms to create various forms of contentGenerative AI leverages algorithms to create various forms of content
Generative AI leverages algorithms to create various forms of content

Software Engineering and Project Management - Introduction, Modeling Concepts...
Software Engineering and Project Management - Introduction, Modeling Concepts...Software Engineering and Project Management - Introduction, Modeling Concepts...
Software Engineering and Project Management - Introduction, Modeling Concepts...

Null Bangalore | Pentesters Approach to AWS IAM
Null Bangalore | Pentesters Approach to AWS IAMNull Bangalore | Pentesters Approach to AWS IAM
Null Bangalore | Pentesters Approach to AWS IAM

LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by AnantLLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant
LLM Fine Tuning with QLoRA Cassandra Lunch 4, presented by Anant

Data Control Language.pptx Data Control Language.pptx
Data Control Language.pptx Data Control Language.pptxData Control Language.pptx Data Control Language.pptx
Data Control Language.pptx Data Control Language.pptx

Comparative analysis between traditional aquaponics and reconstructed aquapon...
Comparative analysis between traditional aquaponics and reconstructed aquapon...Comparative analysis between traditional aquaponics and reconstructed aquapon...
Comparative analysis between traditional aquaponics and reconstructed aquapon...

Embedded machine learning-based road conditions and driving behavior monitoring
Embedded machine learning-based road conditions and driving behavior monitoringEmbedded machine learning-based road conditions and driving behavior monitoring
Embedded machine learning-based road conditions and driving behavior monitoring

Certificates - Mahmoud Mohamed Moursi Ahmed
Certificates - Mahmoud Mohamed Moursi AhmedCertificates - Mahmoud Mohamed Moursi Ahmed
Certificates - Mahmoud Mohamed Moursi Ahmed

Rainfall intensity duration frequency curve statistical analysis and modeling...
Rainfall intensity duration frequency curve statistical analysis and modeling...Rainfall intensity duration frequency curve statistical analysis and modeling...
Rainfall intensity duration frequency curve statistical analysis and modeling...

People as resource Grade IX.pdf minimala
People as resource Grade IX.pdf minimalaPeople as resource Grade IX.pdf minimala
People as resource Grade IX.pdf minimala

BRAIN TUMOR DETECTION for seminar ppt.pdf
BRAIN TUMOR DETECTION for seminar ppt.pdfBRAIN TUMOR DETECTION for seminar ppt.pdf
BRAIN TUMOR DETECTION for seminar ppt.pdf

学校原版美国波士顿大学毕业证学历学位证书原版一模一样
学校原版美国波士顿大学毕业证学历学位证书原版一模一样学校原版美国波士顿大学毕业证学历学位证书原版一模一样
学校原版美国波士顿大学毕业证学历学位证书原版一模一样

cnn.pptx Convolutional neural network used for image classication
cnn.pptx Convolutional neural network used for image classicationcnn.pptx Convolutional neural network used for image classication
cnn.pptx Convolutional neural network used for image classication

Applications of artificial Intelligence in Mechanical Engineering.pdf
Applications of artificial Intelligence in Mechanical Engineering.pdfApplications of artificial Intelligence in Mechanical Engineering.pdf
Applications of artificial Intelligence in Mechanical Engineering.pdf

An improved modulation technique suitable for a three level flying capacitor ...
An improved modulation technique suitable for a three level flying capacitor ...An improved modulation technique suitable for a three level flying capacitor ...
An improved modulation technique suitable for a three level flying capacitor ...

Manufacturing Process of molasses based distillery ppt.pptx
Manufacturing Process of molasses based distillery ppt.pptxManufacturing Process of molasses based distillery ppt.pptx
Manufacturing Process of molasses based distillery ppt.pptx

Seminar on Distillation study-mafia.pptx
Seminar on Distillation study-mafia.pptxSeminar on Distillation study-mafia.pptx
Seminar on Distillation study-mafia.pptx

Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...
Use PyCharm for remote debugging of WSL on a Windo cf5c162d672e4e58b4dde5d797...

spirit beverages ppt without graphics.pptx
spirit beverages ppt without graphics.pptxspirit beverages ppt without graphics.pptx
spirit beverages ppt without graphics.pptx

Project Schedule Management

  • 1. ‫الزمنية‬ ‫والبرامج‬ ‫التخطيط‬ ‫إدارة‬ Project Schedule Management
  • 2. 2 Mohamed Maged Project Management Consultant LLM, MBA, PMP, CCP, P3O • Master in Construction Law – Salford University, Manchester, UK • Master of Business Administration – UoPeople, US • B.Sc. Civil Engineering – Ain Shams University, Egypt • Consultant – Saudi Council of Engineers, Saudi Arabia • CCP, Certified Cost Professional credential – AACE International, US • PMP, Project Management Professional credential – PMI, US • P3O, Portfolio, Programme and Projects Offices credential – AXELOS, UK • FIDIC Contracts Consultant, AIA (Brussels) Fellow • Chartered Institute of Arbitrators (CIArb, UK): Commercial Dispute Resolution • Author of 50 Planning fundamentals & Fundamentals of Construction Contracts • Experience more than 20 years in mega-projects (Buildings, Infrastructure & Roads)
  • 3. @magedkom /in/magedkom ArabPlanners @profplanner Content 1. Planning and scheduling 2. Time schedule development 3. Resource and cost loading 4. Time schedule submittal 5. Review and approval 6. Update and reporting 7. Delay quantification approaches 8. Mitigation and action plans
  • 4. Planning Fundamentals (Section 02 - Scope and Activities) 1-Initial Time Schedule Phases 2-Management Team Engagement 3- Project Lifecycle and Construction 4- WBS Levels 5- Activities Decomposition 7- Calendars Identification 6- Long Lead Items Identification (Section 03 - Duration & Relationships) 8- Activity Duration Estimation 9- Productivity Estimation 10- Relationships Determination 11- Lag Application 12- Milestones Identification 13- LOE Activities Usage (Section 04 - Schedule Submittal) 14- Critical Path Calculation 15- Open End Activities Check 16- Constraints Application 17- Floats Calculation 18- Resource Loading/ Allocation 19- Resource Leveling 21- Cash Flow Considerations 22- Time Schedule Submittal 23- Time Schedule Checks 20- Expenses Assignment Control Fundamentals (Section 06 - Analysis & Reporting) 28- Earned Value Analysis 29- Forecasting using EVM 30- Trend Analysis 31- Levels of Reporting 32- BIM and 4D Scheduling 33- Progress Control & Closing (Section 07 - Delays & Mitigation) 34- Negative Total Float Cases 35- Float Ownership Debate 36- Project Delay Reasons 37- Schedule Compression Techniques 38- Productivity Enhancement 39- Prolongation Cost Eligibility 40- Changes Implications 41- Revised Schedule Cases (Section 08 - EOT Claims) 42- Claims and Disputes 43- EOT Claim Submittal 44- Concurrent Delay 45- Time at Large 46- Delay Analysis Approaches 47- Delay Analysis Documents 48- Types of Contracts 49- Contract and EOT Section 09: 50- Professional Certificates Section 01 - Interview Tips Tentative Schedule and Methodology WBS Activity List Durations Calculation Sheet Milestone List Network Diagram and Bar chart Resource Histograms Cash Flow Project Calendars Scheduling Fundamentals (Section 05 - Schedule Update) 24- Time Schedule Update 25- Activity % Complete Determination 26- Scheduling Approaches 27- Line of Balance Schedule Update & progress layout As-built Schedule and Close out report Monitoring Reports Cost Control Reports Delay Analysis EOT Claim/s Revised Schedule or Recovery Action Plan Delayed Paths Deliverables: Approved Baseline Schedule ……………… Section 10: Samples
  • 5. @magedkom /in/magedkom ArabPlanners @profplanner Planning & Project Management • Scope Management • Schedule Management • Resource Management • Cost Management • Quality Management • HSE Management • Risk Management • Procurement Management • Communication Management • Stakeholder Management • Change Management Planning & Scheduling Planning and scheduling are two terms that are often thought of as synonymous (They are not!). ❑ Scheduling is just one part of the planning effort. Project management is the planning, organizing, directing, and controlling of company resources for a relatively short-term objective that has been established to complete specific goals and objectives.
  • 6. Scheduling (Time & Related Areas - Planning and Control) • Plan Scope Management (Scope Baseline-WBS) • Plan Schedule Management (Activities, Durations and Sequence-CPM) • Plan Resource Management (Responsibilities & Resources Histograms) • Plan Cost Management (Budget, Cash flow & EVM) • Plan Quality Management • Plan HSE Management • Plan Risk Management (Scope, Time & Cost) • Plan Procurement Management (Main and Sub-contracts) • Plan Communication & Stakeholder Management (Reporting and issue log) • Plan Change Management (Project Lifecycle, Claims and Variations) @magedkom /in/magedkom ArabPlanners @profplanner
  • 7. Schedule Development Documents Planner Use: All contract documents such as: • Agreement and scope statement • Design drawings • BOQ (Activity list Vs B.O.Q. Items: https://www.youtube.com/watch?v=r5mplktyT4c) • Contractual requirements (Duration, Technical req. or Specs, Phases and Milestones) • LOA and Access to Site Date (Commencement Date) @magedkom /in/magedkom ArabPlanners @profplanner
  • 8. Work Breakdown Structure WBS: Levels decomposition to WP: • Mob., Engineering, Permits, Procurement, Construction & Close out. • LEVEL 1: PROJECT, LEVEL 2: PHASE, LEVEL 3: WORK TYPE, LEVEL 4: ELEMENT. • (Project, 1-Phase, 2-Location/building-3-floor, 4-Trade) @magedkom /in/magedkom ArabPlanners @profplanner
  • 9. Sequence & Methodology @magedkom /in/magedkom ArabPlanners @profplanner Level 2 Tentative Schedule: High-level Schedule (Kick-off): • Phases, Main Items & Milestones. • Priorities and High-level methodology of construction/ strategy
  • 10. WBS
  • 11. Levels of Detail and Activity List (AACEI 37R-06) @magedkom /in/magedkom ArabPlanners @profplanner It depends on project size and level of control required: Level 0: This is the total project and in effect is a single bar spanning the project time from start to finish. Level 1: This represents the schedule for the project by its major components. A combination of Level 0 schedules for each component project. Level 2: Each schedule component is further subdivided for Level 2. For example, utility systems are further subdivided into water, electrical, gas, storm drainage and sanitary systems, etc. Milestones are normally included. Level 3: The first level that a meaningful critical path network can be displayed and the CPM schedule can be used to monitor and manage (control) the overall project work. Levels 4-X: The level of schedule subdivision continues to whatever is appropriate detail for the user. When operating at more detailed levels, the planners generally work with segments of the total schedule. Often the project “rolling schedule” includes a “look-ahead” period of time (30–180 days) and a “look-back” at recent completed work periods.
  • 12. Activity Durations and Resources Determining the required resources for each activity: Make-or-buy decisions to be taken according to availability, cost and company strategy. Then, durations will be calculated based on the driving recourses of each activity: • Duration = Quantity / (Productivity of crew * no of crews) • Logistics and many other factors may affect productivity. @magedkom /in/magedkom ArabPlanners @profplanner
  • 13. Resource and Cost Loading • Resources can be loaded with cost/unit rates or not (only quantities). • Loading can be with: Cost (Contractor cash out) or BOQ Prices (Contractor cash in = Employer cash out) 3/4M: - Manpower (Labor) - Machinery (Equipment) - Material & Money @magedkom /in/magedkom ArabPlanners @profplanner
  • 14. Productivity Sheets @magedkom /in/magedkom ArabPlanners @profplanner
  • 15. Sequence and Relationships Relationships are FS, SS, FF & SF (Lag can be applied). Lag is +ve waiting period & lead is -ve lag. Activity Name Activity ID Duration ES EF LS LF TF FF Finish Start SS, +ve lag FS, –ve lag (lead) Not recommended FF, lag can be added @magedkom /in/magedkom ArabPlanners @profplanner
  • 16. Schedule (RUN) @magedkom /in/magedkom ArabPlanners @profplanner
  • 17. Critical Path and TF CPM: Forward and backward calculation: • TF = Late dates – Early dates A 5 D 3 C 5 G 4 E 3 F 4 H 7 I 8 J 2 K 3 L 2 PF 0, 5 0, 5 5, 11 5, 10 5, 8 11, 15 11, 14 8, 12 15, 17 15, 23 12, 19 23, 25 19, 22 25 23, 25 22, 25 15, 23 20, 22 15, 22 12, 15 11, 15 11, 15 5, 11 6, 11 8, 11 0 0 0 +1 0 0 +1 5 3 3 3 3 25 B 6 0 @magedkom /in/magedkom ArabPlanners @profplanner
  • 18. Schedule Submittal • Sequence Layout • WBS • Milestone List • Project Calendars • Resources Dictionary • Activity List • Productivity Sheet • Duration Calculation • Bar Chart (Summary, Detailed & CP) • Resources Histogram • Material Requirements • Cash Flow • Schedule Narrative @magedkom /in/magedkom ArabPlanners @profplanner
  • 21. Review and Approval 1. Does the time schedule cover the scope of work properly without any exclusion or extra work? 2. Is the decomposition level of WBS appropriate for planning and control? 3. Is the level of detail and activities durations appropriate for planning and control? 4. Is the critical path logical and either the total float of all paths/ activities? 5. Does the schedule basis/ narrative include all assumptions used and information required? 6. Are the attached resources histograms and cash flow workable? 7. Are the calculations of cost and resources loading sheets correct? 8. Does the time schedule consider all contractual and technical requirements? The US DCMA uses 14-Point Assessment Checks consist of the following items: 1. Logic 2. Leads 3. Lags 4. Relationship Types 5. Hard Constraints 6. High Float 7. Negative Float 8. High Duration 9. Invalid Dates 10. Resources 11. Missed Tasks 12. Critical Path Test 13. Critical Path Length Index (CPLI) 14. Baseline Execution Index (BEI)
  • 23. Planning team monitors all items related to time schedule which may impact the project duration such as progress, sequence of work, resources, productivity, EV, risks, procurement, changes … etc. They normally prepare reports in this regard with the expected impact and proposed corrective actions. Monitoring and Control @magedkom /in/magedkom ArabPlanners @profplanner
  • 24. To update the progress of activities, there are two cases: 1- Ongoing activities: Actual start, % complete, suspension (if any) & remaining duration/ exp. finish date (if required). 2- Completed activities (100%): Actual start & Actual Finish. Actual cost and resources can be updated. Any change in relationships should be subject to notification or approval. Data Date of programme updating: https://www.youtube.com/watch?v=Evzc1TbS6X8 Update time schedule (method & checks): https://www.youtube.com/watch?v=vnC9KkGZyO8 Update and Reporting @magedkom /in/magedkom ArabPlanners @profplanner
  • 25. • Level 1 – Executive Summary Level (Dashboard, Flash report): overall project plan, progress and current forecast, rate: monthly, quarterly. • Level 2 – Summary Level (Client presentation): Status reports include selected activities/major trades which are extracted from the overall Level 2 Master Programme, rate: monthly, fortnightly. • Level 3 – Management Level: represent the work sequence and programme, in detail sufficient to plan and monitor weekly activities at the contractor working level, ‘look ahead programmes’, rate: weekly, biweekly contains cumulative. • Level 4 – Site Level (Daily): the daily progress lists or tick-sheets, which are developed and maintained by each department, section or trade. Levels of Reporting @magedkom /in/magedkom ArabPlanners @profplanner
  • 26. Delay Quantification 1 Total Float = Update Finish date – Baseline Finish date (Delay =-ve TF) 3 SV = EV – PV, EV = Ʃ(Performance%*BC), PV = Ʃ(Scheduled%*BC) -ve SV: Delay = SV / Daily planned budget (BAC/Duration) 4 Earned Schedule: SPI = PT/AT (SPI > 1 means behind schedule: Delay) SV: Delay = AT – PT, PT = The planned (earned) duration of the EV 5 Trend analysis (Forecasting): Extending the curve of EV Delay = Expected Finish date – Baseline Finish date 2 LOB (Repetitive activities): Resource-based schedules Apply the resource limits (Leveling) and logic productivity on the remaining work Var. now VAC SV Remaining 6 EVM Forecasting: 3 approaches 1- Maintain the variance till end. 2- Magnify the variance. 3- Recalculation for the remaining work to consider all factors. SV @magedkom /in/magedkom ArabPlanners @profplanner
  • 27. Baseline (TF=0) Update TF=0 while Performance%>Scheduled% Data Date Data Date
  • 28. 2- Line Of Balance Data Date Delay: 1W Ahead: 4D Dealy: 9D
  • 29. 29 29 (earned value) (Invoices) (planned value) Cost baseline 3- SV= -1,067$ Daily planned budget= 266.67 $ / day 1- TF= -15 Days 5- Trend analysis delay= -35 days % Complete = 26.7% = - 4 days ‫ععععع‬‫ع‬ ‫ععععع‬‫ع‬‫الجم‬ ‫ا‬ ‫ععععععععع‬‫ع‬‫المؤش‬ ‫المختلفة‬ ... ETC: time schedule update 4- ES, Var= -6 Days
  • 30. ‫صحته‬ ‫على‬ ‫تؤثر‬ ‫التي‬ ‫العوامل‬ ‫مناسبا‬ ‫يكون‬ ‫متى‬ ‫فائدته‬ ‫المؤشر‬ ‫تعو‬ ‫ال‬ ‫جة‬ ‫ح‬ ‫غ‬ ‫أنشطة‬ ‫في‬ ‫تقدم‬ ‫وجود‬ ‫ض‬ ‫ك‬ ‫م‬ ‫ق‬ ‫أنشطة‬ ‫أو‬ ‫ج‬ ‫الح‬ ‫لمسا‬ ‫تأخ‬ ‫ة‬ ‫العكس‬ ‫أو‬ ‫ة‬ ‫صغ‬ ‫ذ‬ ‫تنف‬ ‫مدد‬ ‫تحتاج‬ ‫قة‬ ‫السا‬ ‫األنشطة‬ ‫ه‬ ‫تشا‬ ‫عند‬ ‫وال‬ ‫مة‬ ‫الق‬ ‫تكو‬ ‫ث‬ ‫ح‬ ‫والالحقة‬ ‫مدة‬ ‫ة‬ ‫د‬ ‫ط‬ ‫عالقة‬ ‫في‬ ‫المخططة‬ ‫األعمال‬ ‫مة‬ ‫ق‬ ‫حساب‬ ‫ة‬ ‫المكتس‬ ‫مة‬ ‫الق‬ ‫نتها‬ ‫ومقا‬ Schedule performance index ‫ة‬ ‫المكتس‬ ‫مة‬ ‫الق‬ ‫مؤش‬ (SPI) ‫ا‬ ‫االخت‬ ‫العالقا‬ ‫م‬ ‫د‬ ‫العد‬ ‫وجود‬ ‫عند‬ ‫ة‬ ‫مطل‬ ‫تسلسل‬ ‫ة‬ ‫و‬ ‫الض‬ ‫تعكس‬ ‫ال‬ ‫التي‬ ‫وب‬ ‫األعمال‬ ‫ذ‬ ‫لتنف‬ ‫معظم‬ ‫ط‬ ‫و‬ ‫منطقي‬ ‫كو‬ ‫عندما‬ ‫إلزامي‬ ‫منطق‬ ‫العالقا‬ ‫ؤخ‬ ‫قد‬ ‫والذي‬ ‫األطول‬ ‫المسا‬ ‫د‬ ‫تحد‬ ‫ه‬ ‫تأخ‬ ‫عند‬ ‫وع‬ ‫المش‬ Critical path ‫ج‬ ‫الح‬ ‫المسا‬ ‫عض‬ ‫على‬ ‫ة‬ ‫ا‬ ‫التك‬ ‫األنشطة‬ ‫اعتماد‬ ‫عدم‬ ‫ها‬ ‫المدخلة‬ ‫اإلنتاج‬ ‫معدال‬ ‫صحة‬ ‫عدم‬ ‫أو‬ ‫ة‬ ‫ا‬ ‫التك‬ ‫األنشطة‬ ‫اعتماد‬ ‫عند‬ ‫أح‬ ‫معدال‬ ‫وتأث‬ ‫عضها‬ ‫على‬ ‫د‬ ‫وع‬ ‫المش‬ ‫على‬ ‫األنشطة‬ ‫ا‬ ‫التك‬ ‫األنشطة‬ ‫معدال‬ ‫ح‬ ‫توض‬ ‫ة‬ ‫نها‬ ‫ما‬ ‫ف‬ ‫واالتزا‬ Line of Balance ‫االتزا‬ ‫خط‬ ‫واختالف‬ ‫ة‬ ‫ق‬ ‫المت‬ ‫األعمال‬ ‫ه‬ ‫تشا‬ ‫عدم‬ ‫ة‬ ‫المطلو‬ ‫د‬ ‫والموا‬ ‫وف‬ ‫الظ‬ ‫قة‬ ‫السا‬ ‫األنشطة‬ ‫ه‬ ‫تشا‬ ‫عند‬ ‫األعمال‬ ‫تحتاج‬ ‫ث‬ ‫ح‬ ‫والالحقة‬ ‫هة‬ ‫مشا‬ ‫لمدد‬ ‫ة‬ ‫ق‬ ‫المت‬ ‫معدل‬ ‫متوسط‬ ‫ا‬ ‫استم‬ ‫أث‬ ‫ح‬ ‫توض‬ ‫ق‬ ‫السا‬ ‫اإلنتاج‬ Trend analysis ‫االمتداد‬ ‫ل‬ ‫تحل‬ ‫المسا‬ ‫م‬ ‫د‬ ‫العد‬ ‫تكدس‬ ‫حدوث‬ ‫عند‬ ‫ا‬ ‫ز‬ ‫حتاج‬ ‫ة‬ ‫ق‬ ‫المت‬ ‫المدة‬ ‫في‬ ‫واألنشطة‬ ‫ادة‬ ‫د‬ ‫الموا‬ ‫في‬ ‫ة‬ ‫ك‬ ‫األنشط‬ ‫وعالقا‬ ‫ممد‬ ‫ة‬ ‫منطق‬ ‫عند‬ ‫ة‬ ‫ذها‬ ‫تنف‬ ‫ة‬ ‫وإمكان‬ ‫ة‬ ‫ق‬ ‫المت‬ ‫د‬ ‫الموا‬ ‫المتاحة‬ ‫ا‬ ‫ومسا‬ ‫والعالقا‬ ‫المدد‬ ‫ح‬ ‫توض‬ ‫وع‬ ‫المش‬ ‫أنشطة‬ Total float ‫الكلي‬ ‫الفائض‬
  • 31. There are two techniques to compress a time schedule: 1- Crashing: Selecting specific critical activities for crashing to shorten project duration (increase resources – refer to duration equation). 2- Fast-tracking: Re-sequence the logic and overlap activities that can be done at the same time. 3- Merge and do both together. Compression approaches @magedkom /in/magedkom ArabPlanners @profplanner
  • 32. Types of Delay Neutral Event In-Excusable (CRE) Excusable ERE Concurrent Delay Consequences: After a certain delay threshold or in case of EOT or changes, a revised schedule will be required. @magedkom /in/magedkom ArabPlanners @profplanner
  • 33. Cases of EOTs - SA ‫الحكومية‬ ‫والمشتريات‬ ‫المنافسات‬ ‫نظام‬ ( ‫السعودي‬ ) ‫والخمسون‬ ‫الحادية‬ ‫المادة‬ : ‫ئة‬ ‫طا‬ ‫وف‬ ‫ظ‬ ‫ع‬ ‫ا‬ً‫ج‬‫نات‬ ‫التأخ‬ ‫كا‬ ‫إذا‬ ‫ة‬ ‫المال‬ ‫ة‬ ‫وزا‬ ‫م‬ ‫المتعاقدة‬ ‫ة‬ ‫الحكوم‬ ‫الجهة‬ ‫اتفاق‬ ‫امة‬ ‫الغ‬ ‫م‬ ‫واإلعفاء‬ ‫العقد‬ ‫د‬ ‫تمد‬ ‫تم‬ ( Exceptional events ) ‫المتعاقد‬ ‫ادة‬ ‫إ‬ ‫ع‬ ‫ج‬ ‫خا‬ ‫ب‬ ‫لس‬ ‫أو‬ ، ( Out of control ) ‫اب‬ ‫األس‬ ‫هذه‬ ‫م‬ ‫التأخ‬ ‫مدة‬ ‫تتناسب‬ ‫أ‬ ‫ط‬ ‫ش‬ ، . ‫والخمسون‬ ‫الثانية‬ ‫المادة‬ : ‫ة‬ ‫التال‬ ‫الحاال‬ ‫في‬ ‫العقد‬ ‫د‬ ‫تمد‬ ‫المستقلة‬ ‫ة‬ ‫الدائ‬ ‫س‬ ‫ئ‬ ‫أو‬ ‫المختص‬ ‫للوز‬ : ‫أ‬ - ‫العقد‬ ‫في‬ ‫د‬ ‫و‬ ‫ما‬ ‫على‬ ‫ة‬ ‫إضاف‬ ‫أعمال‬ ‫المتعاقد‬ ‫كلف‬ ‫إذا‬ ( Variation/ additional work ) ‫حجم‬ ‫م‬ ‫ة‬ ‫متناس‬ ‫المضافة‬ ‫المدة‬ ‫تكو‬ ‫أ‬ ‫ط‬ ‫ش‬ ، ‫ها‬ ‫ف‬ ‫التكل‬ ‫خ‬ ‫وتا‬ ‫عتها‬ ‫وط‬ ‫األعمال‬ . ‫ب‬ - ‫للمتعاقد‬ ‫تعود‬ ‫ال‬ ‫اب‬ ‫ألس‬ ‫عضها‬ ‫أو‬ ‫األعمال‬ ‫قاف‬ ‫إ‬ ‫ة‬ ‫الحكوم‬ ‫الجهة‬ ‫م‬ ‫أم‬ ‫صد‬ ‫إذا‬ ( Suspension .) - ‫المحدد‬ ‫الوق‬ ‫في‬ ‫العمل‬ ‫إلنجاز‬ ‫ة‬ ‫كاف‬ ‫غ‬ ‫وع‬ ‫للمش‬ ‫ة‬ ‫السنو‬ ‫ة‬ ‫المال‬ ‫االعتمادا‬ ‫كان‬ ‫إذا‬ ( Cash flow .) @magedkom /in/magedkom ArabPlanners @profplanner
  • 34. EOT Claim Content ‫يلي‬ ‫ما‬ ‫الزمني‬ ‫للبرنامج‬ ‫يضاف‬ ‫الزمنية‬ ‫التمديدات‬ ‫حالة‬ ‫في‬ : 1 - ‫ة‬ ‫المطال‬ ‫هذه‬ ‫الى‬ ‫أد‬ ‫التي‬ ‫االحداث‬ ‫ف‬ ‫تع‬ 2 - ‫م‬ ‫إلى‬ ‫ة‬ ‫االشا‬ ‫جة‬ ‫والنت‬ ‫األث‬ ‫ا‬ ‫ل‬ ‫ا‬ ‫المطال‬ ‫احداث‬ ‫د‬ ‫س‬ ‫ستندا‬ ‫فاقها‬ ‫وا‬ ‫ا‬ ‫االث‬ 3 - ‫المتعل‬ ‫ة‬ ‫التعاقد‬ ‫اءا‬ ‫واالج‬ ‫نود‬ ‫ال‬ ‫م‬ ‫قة‬ ‫السا‬ ‫دا‬ ‫التمد‬ ‫قة‬ ‫المقاول‬ ‫ة‬ ‫وأحق‬ ‫الموضوع‬ 4 - ‫ا‬ ‫امج‬ ‫ال‬ ‫م‬ ‫تقد‬ ‫في‬ ‫طلب‬ ‫ما‬ ‫شامل‬ ‫المعدل‬ ‫الزمني‬ ‫نامج‬ ‫ال‬ ‫ة‬ ‫لزمن‬ ‫األصلي‬ ‫ج‬ ‫الح‬ ‫المسا‬ ‫نة‬ ‫مقا‬ ‫م‬ 5 - ‫الم‬ ‫د‬ ‫الجد‬ ‫التعاقدي‬ ‫ة‬ ‫النها‬ ‫خ‬ ‫وتا‬ ‫الزمني‬ ‫د‬ ‫التمد‬ ‫خالصة‬ ‫طلوب‬ 6 - ‫مها‬ ‫ق‬ ‫ت‬ ‫م‬ ‫د‬ ‫الس‬ ‫في‬ ‫ها‬ ‫ال‬ ‫ة‬ ‫االشا‬ ‫تم‬ ‫التي‬ ‫فقا‬ ‫الم‬ @magedkom /in/magedkom ArabPlanners @profplanner
  • 35. One type of revised schedule is the recovery schedule. If the delay is caused by CRE and it’s beyond the delay threshold, the contractor has to prepare a recovery schedule to recover this delay. Recovery Schedule @magedkom /in/magedkom ArabPlanners @profplanner
  • 36. Action Plan The action plan should include the actions that will be taken to recover the delay such as: New planned productivity and planned dates with a roadmap of how to achieve them. For example: - Any change in roles and responsibilities of the current team. - Additional staff and resources with the deployment plan. - Any change in procurement plan or additional subcontractors/ suppliers. - Proposed changes in sequence or construction techniques. - Any additional measures would be used for monitoring and control. @magedkom /in/magedkom ArabPlanners @profplanner
  • 37. Recap 1. Planning and scheduling (Project management - Planning and control) 2. Time schedule development (WBS, Activity list/dur.s, Relationships & CPM) 3. Resource and cost loading (Resources histograms and cash flow) 4. Time schedule submittal (Assumptions and deliverables) 5. Review and approval (Technical and contractual review - Baseline) 6. Update and reporting (Collecting data, checks & levels of reporting) 7. Delay quantification approaches (TF, LOB, SV, ES, Trend analysis & Forecasting) 8. Mitigation and action plans (Types of delay, EOT cases, Revised & recovery schedule) @magedkom /in/magedkom ArabPlanners @profplanner
  • 38. Related Lectures and Courses Course at Luqman Academy YouTube Lectures 38
  • 39. ‫نشرته‬ ‫ما‬ ‫آخر‬ ‫حديثا‬ ‫في‬ ‫متكاملة‬ ‫دورة‬ ‫التأخير‬ ‫تحليل‬ ‫باستخ‬ ‫أبرز‬ ‫دام‬ ‫من‬ ‫الصادرة‬ ‫المراجع‬ AACE, SCL, RICS, ASCE ‫الفني‬ ‫المصادر‬ ‫من‬ ‫والعديد‬ ‫ة‬ ‫والقانونية‬ ... ‫مع‬ ‫الخاصة‬ ‫الحاالت‬ ‫مناقشة‬ ‫تشمل‬ ‫كما‬ ،‫وآثارها‬ ‫معالجته‬ ‫وطرق‬ ‫للتأخير‬ ‫تقديم‬ ‫لكيفية‬ ‫توضيح‬ ‫الدورة‬ ‫مطالب‬ ‫ات‬ ‫ا‬ ‫لتمديد‬ ‫لها‬ ‫عملي‬ ‫ومثال‬ ‫ومكوناتها‬ ‫المشروع‬ ‫لمدة‬ .
  • 40. Thank You Don’t Hesitate to contact…. M.Maged magedkom@gmail.com mobile : 00966-580264968
