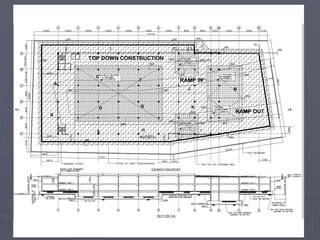

TOP DOWN
CONSTRUCTION


  By- Gagan Goswami

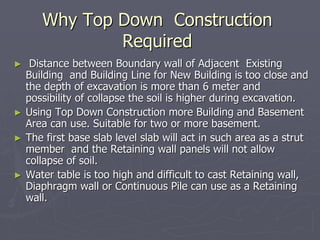

Why Top Down Construction
               Required
►    Distance between Boundary wall of Adjacent Existing
    Building and Building Line for New Building is too close and
    the depth of excavation is more than 6 meter and
    possibility of collapse the soil is higher during excavation.
►   Using Top Down Construction more Building and Basement
    Area can use. Suitable for two or more basement.
►   The first base slab level slab will act in such area as a strut
    member and the Retaining wall panels will not allow

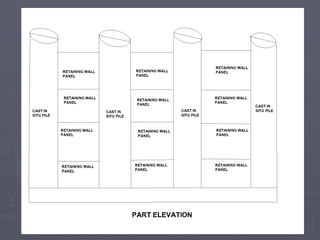

    collapse of soil.
►   Water table is too high and difficult to cast Retaining wall,
    Diaphragm wall or Continuous Pile can use as a Retaining
    wall.
METHODOLOGY OF TOP DOWN
          CONSTRUCTION
1.   Setting out for alignment of bore cast in situ of
     piles .
2.   Bore Cast in Situ Piles to be cast and dowels bar
     to be kept for Retaining wall panels. The center
     of piles and Retaining wall panels center line to
     be kept in same line. The Diameter of Piles
     preferred 600 mm, distance between two piles
     center to center preferred 3.33 meters (Suit for
     C/C distance of Columns), Depth of Piles to be

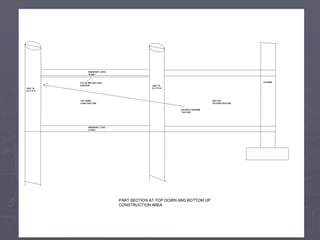

     confirmed by Structural Consultants.
3.   Touching Piles can use as a Retaining wall with
     supporting arrangement during Excavation.
4.   If area of Basement is more and Span is less
     Diaphragm wall can be use as a Retaining wall.

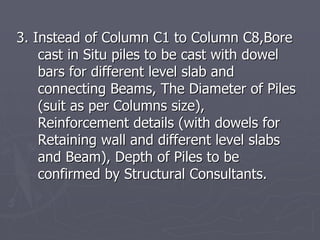

3. Instead of Column C1 to Column C8,Bore
    cast in Situ piles to be cast with dowel
    bars for different level slab and
    connecting Beams, The Diameter of Piles
    (suit as per Columns size),
    Reinforcement details (with dowels for
    Retaining wall and different level slabs
    and Beam), Depth of Piles to be

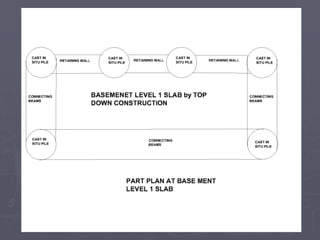

    confirmed by Structural Consultants.

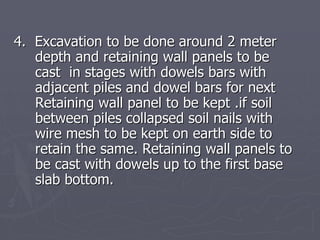

4. Excavation to be done around 2 meter
   depth and retaining wall panels to be
   cast in stages with dowels bars with
   adjacent piles and dowel bars for next
   Retaining wall panel to be kept .if soil
   between piles collapsed soil nails with
   wire mesh to be kept on earth side to
   retain the same. Retaining wall panels to
   be cast with dowels up to the first base
   slab bottom.

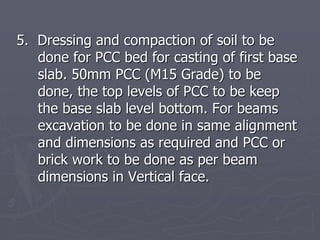

5. Dressing and compaction of soil to be
   done for PCC bed for casting of first base
   slab. 50mm PCC (M15 Grade) to be
   done, the top levels of PCC to be keep
   the base slab level bottom. For beams
   excavation to be done in same alignment
   and dimensions as required and PCC or
   brick work to be done as per beam
   dimensions in Vertical face.

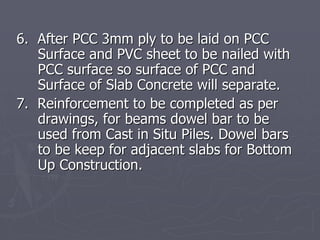

6. After PCC 3mm ply to be laid on PCC
   Surface and PVC sheet to be nailed with
   PCC surface so surface of PCC and
   Surface of Slab Concrete will separate.
7. Reinforcement to be completed as per
   drawings, for beams dowel bar to be
   used from Cast in Situ Piles. Dowel bars
   to be keep for adjacent slabs for Bottom
   Up Construction.

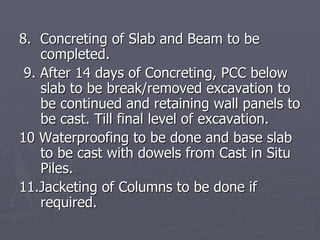

8. Concreting of Slab and Beam to be
    completed.
 9. After 14 days of Concreting, PCC below
    slab to be break/removed excavation to
    be continued and retaining wall panels to
    be cast. Till final level of excavation.
10 Waterproofing to be done and base slab
    to be cast with dowels from Cast in Situ
    Piles.
11.Jacketing of Columns to be done if
    required.
►THANKS
