Project Human Resource Management
• Process Groups & Knowledge Areas Mapping
Knowledge Area
Process
Initiating Planning Executing Monitoring & Control Closing
Integration Develop
Project
Charter
Develop Project Management
Plan
Direct and Manage Project
Execution
Monitor and Control Project
Work
Perform Integrated Change
Control
Close Project
Scope Collect Requirements
Define Scope
Create WBS
Verify Scope
Control Scope
Time Define Activities
Sequence Activities
Estimate Activities Resources
Estimate Activities Duration
Develop Schedule
Control Schedule
Cost Estimate Costs
Determine Budget
Control Costs
Quality Plan Quality Perform Quality Assurance Perform Quality Control
Human
Resource
Develop Human Resources Plan Acquire Project Team
Develop Project Team
Manage Project Team
Communication Identify
Stakeholders
Plan Communications Distribute Information
Manage Stakeholders
Expectations
Report Performance
Risk Plan Risk Management
Identify Risk
Perform Qualitative Risk Analysis
Perform Quantitative Risk
Analysis
Plan Risk Response
Monitor and Control Risks
Procurement Plan Procurements Conduct Procurements Administer Procurements Close
Procurements
Project Human Resource Management
Knowledge Area
Process
Initiating Planning Executing
Monitoring &
Contol
Closing
Human
Resource
Develop Human
Resource Plan
Acquire Project Team
Develop Project Team
Manage Project Team
Enter phase/
Start project
Exit phase/
End project
Initiating
Processes
Closing
Processes
Planning
Processes
Executing
Processes
Monitoring &
Controlling Processes
• subset of the project team and is responsible
for the project management and leadership
activities
• . It is Called the core, executive, or leadership
team.
• The project sponsor works with the project
management team in order to benefit the
project.
The project management team

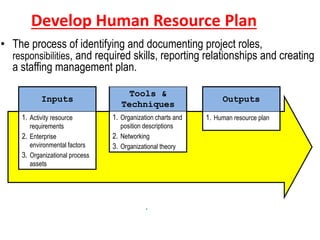

Develop Human Resource Plan
• The process of identifying and documenting project roles,
responsibilities, and required skills, reporting relationships and creating
a staffing management plan.
Inputs
1. Activity resource
requirements
2. Enterprise
environmental factors
3. Organizational process
assets
Tools &
Techniques
1. Organization charts and
position descriptions
2. Networking
3. Organizational theory
Outputs
1. Human resource plan
.
Activity Resource Requirements
. The preliminary requirements regarding the required
people and competencies for the project team members
are progressively elaborated as part of the human
resource planning process.
Organization Chart & Position Desc.
– Hierarchical Organizational Chart
– e.g. Organizational Breakdown Structure (OBS)
Project manager
HR manager Quality manager
Civil construction
manager
Planning manager Procurement manager
Organizational Breakdown Structure (OBS)
. RACI (responsible, accountable, consult, inform)
Responsibility Assignment Matrix (RAM) Using a RACI Format
Mixed based charts
• Text-oriented
ROLES AND RESPONSIBILITIES
Project Title: Date Prepared:
Resource Role Description:
Provides the role or job title and a brief description of the role.
Authority:
Defines the decision-making limits for each role. Examples include alternative
selection, conflict management, prioritizing, rewarding and penalizing, etc. Also
indicates reporting structure.
Responsibility:
Defines the activities that the role carries out and the nature of the contribution to
the final product, service, or result. Examples include job duties, processes
involved, and hand-offs to other people.
Qualifications:
Describes any prerequisites, experience, licenses, seniority levels, or other
qualifications necessary to fulfill the role.
Competencies:
Describes specific role or job skills and competencies. May include details on
languages, technology, or other information necessary to complete the role
successfully.
ROLES AND RESPONSIBILITIES
Project Title: Date Prepared:
Resource Role Description:
Provides the role or job title and a brief description of the role.
Authority:
Defines the decision-making limits for each role. Examples include alternative
selection, conflict management, prioritizing, rewarding and penalizing, etc. Also
indicates reporting structure.
Responsibility:
Defines the activities that the role carries out and the nature of the contribution to
the final product, service, or result. Examples include job duties, processes
involved, and hand-offs to other people.
Qualifications:
Describes any prerequisites, experience, licenses, seniority levels, or other
qualifications necessary to fulfill the role.
Competencies:
Describes specific role or job skills and competencies. May include details on
languages, technology, or other information necessary to complete the role
successfully.
ROLES AND RESPONSIBILITIES
Project Title: Constructing private hospital Date Prepared: 23/11/2012
Resource Role Description:
Human resource manager
Authority:
The manager of HR department ,use reward and penalty system for dep. He
can give Special incentives for department employees . .
Responsibility:
Preparing hr management plan , sharing in acquiring team procedures.
Preparing development team plan, monitoring
Qualifications:
Bech. Degree of administration science, (MBA) preferable
Competencies:
at least 10 years experience in hr field in a big projects
Ability to lead and communicate with others
Fluent in English read and written
Human Resource Plan (Output)
HR plan includes (but not limited to)
1. Roles and responsibilities
• Role
• Authority
• Responsibility
• Competency
2. Project Organization Chart
3. Staffing Management Plan
• Staff Acquisition
• Resource calendars
• Staff release plan
• Training needs
• Recognition and rewards
• Compliance, Safety.
• Resource Histogram
Bar chart shows number
of resource used per
time period
HUMAN RESOURCE PLAN
Project Title: Date Prepared:
Roles, Responsibilities, and Authority:
Role: Authority: Responsibility:
1. Defines the role or
job title.
1. Defines decision
making limits.
1. Defines the duties.
2.
Project Organizational Structure:
Insert an organizational chart for the project.
May include an organizational chart of the enterprise and how the project
fits within the enterprise.
HUMAN RESOURCE PLAN
Staffing Management Plan
Staff Acquisition:
Describes how staff will be brought on to the project. Defines any differences between
internal staff team members and outsourced team members with regards to on boarding
procedures.
Staff Release:
Describes how team members will be released from the team, including knowledge transfer,
and check out procedures for staff and outsourced team members.
Resource Calendars:
Shows any unusual resource calendars such as abbreviated work weeks, vacations, and time
constraints for team members that are less than full time.
Training Needs:
Describes any required training on equipment, technology or company processes.
Rewards and Recognition:
Describes any reward and recognition processes or limitations.
Regulations, Standards, and Policy Compliance:
All team must comply with company rules
Safety:
There are safety plan in site approved by OSHA
HUMAN RESOURCE PLAN
Project Title: Constructing private hospital Date Prepared: 23/11/2012
Roles, Responsibilities, and Authority:
Role: Authority: Responsibility:
1. Project Manager . 1. Have authority to
accomplish project
management work.
2. Have authority to
approve change request
1. responsible for the
overall success of the
Project
Project Organizational Structure:
.
HUMAN RESOURCE PLAN
Staffing Management Plan
Staff Acquisition:
Staff are acquired from organization and the remaining jobs can we make interview to acquire
project team some jobs are acquired by subcontractors
Staff Release:
Every employee know the date of release after finishing his roles in project
Resource Calendars:
5 days in weak Friday and Saturday (vacation) 8 hrs in day.
Training Needs:
Trainning plan include onshore and offshore training.
Rewards and Recognition:
The company will provide free family movie tickets for the top two performers on project.
Regulations, Standards, and Policy Compliance:
Safety:
Describes any safety regulations, equipment, training, or procedures.
Acquire Project Team
• The process of confirming human resource availability and
obtain the team necessary to complete project assignments.
Inputs
1. Project management
plan
2. Enterprise
environmental factors
3. Organizational process
assets
Tools &
Techniques
1. Pre-assignment
2. Negotiation
3. Acquisition
4. Virtual teams
Outputs
1. Project staff assignment
2. Resource calendars
3. Project management
plan updates
Pre assignment
When project team members
are selected in advance they
are considered pre-assigned.
- if the project is dependent
upon the expertise of
particular persons, or if some
staff assignments are defined
within the project charter
Negotiation
• negotiate with:
- Functional managers to
ensure that the project
receives appropriately
competent staff in the
required time frame
- Performing organization
resource or specialized
human resources
Acquisition
• When the performing
organization lacks the
in-house staff needed
to complete a project,
the required services
may be acquired from
outside sources. This
can involve hiring
individual consultants
or subcontracting work
Virtual Teams
- groups of people with a shared
goal not meeting face to face
- Add special expertise from
different countries
- Communication planning
becomes increasingly
important
Project Staff Assignments
- people have been assigned
through the previously described
methods.
- The documentation include a
project team directory, memos to
team members, and names
QUESTIONS?
1-You are newly appointed as a project manager of an
ongoing project. You want to see the role, authority,
responsibility and competencies of all the resources
working in the project. Which of the following
document lists all the above information?
1.Scope statement
2.Project Charter
3.Human Resource Plan
4.WBS
2- Resource Breakdown Structure is an example
of:
1-Hierarchical-type Organizational Chart
2-Responsibility Assignment Matrix
3-Text-oriented Format
4-Functional Chart
3- All of the following can be used to document
team member roles and responsibilities
EXCEPT:
1-Hierarchical-type Organizational Chart
2-Matrix-based Responsibility Chart
3-Text-oriented Format
4-Functional Chart
4-Which of the following best describe what is included
in a staffing management plan?
A- a plan regarding what details about the project should
go to whom and when the details need to be sent.
B- how the team will implement plans for ensuring the
project will satisfy the needs which it was undertaken
C. when and how human resource will be brought into
and taken off the project team
D-if independent estimates are needed who will prepare
them and when
5-in creating a project management plan, how
should a project manager use rewards
A- use the reward system currently in place
throughout the company
B- ignore rewards because the functional manager
will take care of it
C- create a specific reward system for the project
D- ignore rewards because they are managements
responsibility
•6- Which of the following is the most important
element of Project Management Plan that is
useful in HR Planning process:
A.Risk Management activities
B.Quality Assurance activities
C.Activity Resource requirements
D.Budget Control activities
7-Which of the following is not true for a Responsibility
Assignment Matrix (RAM)
A.Defines what project team is responsible for each WBS
component
B.Defines what project member is responsible for each
activity
C.Text description of roles, responsibilities, authorities
D.Defines all people associated with each activity
8-Which chart allows a project manager to indicate
the number of resources used each month?
• A- Responsibility Assignment Matrix
• B-Resource histogram
• C-project organizational chart
• D- pareto chart
Thank you

Session 14 4th edition PMP

  • 1.
  • 2.
    • Process Groups& Knowledge Areas Mapping Knowledge Area Process Initiating Planning Executing Monitoring & Control Closing Integration Develop Project Charter Develop Project Management Plan Direct and Manage Project Execution Monitor and Control Project Work Perform Integrated Change Control Close Project Scope Collect Requirements Define Scope Create WBS Verify Scope Control Scope Time Define Activities Sequence Activities Estimate Activities Resources Estimate Activities Duration Develop Schedule Control Schedule Cost Estimate Costs Determine Budget Control Costs Quality Plan Quality Perform Quality Assurance Perform Quality Control Human Resource Develop Human Resources Plan Acquire Project Team Develop Project Team Manage Project Team Communication Identify Stakeholders Plan Communications Distribute Information Manage Stakeholders Expectations Report Performance Risk Plan Risk Management Identify Risk Perform Qualitative Risk Analysis Perform Quantitative Risk Analysis Plan Risk Response Monitor and Control Risks Procurement Plan Procurements Conduct Procurements Administer Procurements Close Procurements
  • 3.
    Project Human ResourceManagement Knowledge Area Process Initiating Planning Executing Monitoring & Contol Closing Human Resource Develop Human Resource Plan Acquire Project Team Develop Project Team Manage Project Team Enter phase/ Start project Exit phase/ End project Initiating Processes Closing Processes Planning Processes Executing Processes Monitoring & Controlling Processes
  • 4.
    • subset ofthe project team and is responsible for the project management and leadership activities • . It is Called the core, executive, or leadership team. • The project sponsor works with the project management team in order to benefit the project. The project management team
  • 5.
    Develop Human ResourcePlan • The process of identifying and documenting project roles, responsibilities, and required skills, reporting relationships and creating a staffing management plan. Inputs 1. Activity resource requirements 2. Enterprise environmental factors 3. Organizational process assets Tools & Techniques 1. Organization charts and position descriptions 2. Networking 3. Organizational theory Outputs 1. Human resource plan .
  • 6.
    Activity Resource Requirements .The preliminary requirements regarding the required people and competencies for the project team members are progressively elaborated as part of the human resource planning process.
  • 7.
    Organization Chart &Position Desc. – Hierarchical Organizational Chart – e.g. Organizational Breakdown Structure (OBS)
  • 8.
    Project manager HR managerQuality manager Civil construction manager Planning manager Procurement manager Organizational Breakdown Structure (OBS)
  • 9.
    . RACI (responsible,accountable, consult, inform) Responsibility Assignment Matrix (RAM) Using a RACI Format Mixed based charts
  • 10.
  • 11.
    ROLES AND RESPONSIBILITIES ProjectTitle: Date Prepared: Resource Role Description: Provides the role or job title and a brief description of the role. Authority: Defines the decision-making limits for each role. Examples include alternative selection, conflict management, prioritizing, rewarding and penalizing, etc. Also indicates reporting structure. Responsibility: Defines the activities that the role carries out and the nature of the contribution to the final product, service, or result. Examples include job duties, processes involved, and hand-offs to other people. Qualifications: Describes any prerequisites, experience, licenses, seniority levels, or other qualifications necessary to fulfill the role. Competencies: Describes specific role or job skills and competencies. May include details on languages, technology, or other information necessary to complete the role successfully.
  • 12.
    ROLES AND RESPONSIBILITIES ProjectTitle: Date Prepared: Resource Role Description: Provides the role or job title and a brief description of the role. Authority: Defines the decision-making limits for each role. Examples include alternative selection, conflict management, prioritizing, rewarding and penalizing, etc. Also indicates reporting structure. Responsibility: Defines the activities that the role carries out and the nature of the contribution to the final product, service, or result. Examples include job duties, processes involved, and hand-offs to other people. Qualifications: Describes any prerequisites, experience, licenses, seniority levels, or other qualifications necessary to fulfill the role. Competencies: Describes specific role or job skills and competencies. May include details on languages, technology, or other information necessary to complete the role successfully.
  • 13.
    ROLES AND RESPONSIBILITIES ProjectTitle: Constructing private hospital Date Prepared: 23/11/2012 Resource Role Description: Human resource manager Authority: The manager of HR department ,use reward and penalty system for dep. He can give Special incentives for department employees . . Responsibility: Preparing hr management plan , sharing in acquiring team procedures. Preparing development team plan, monitoring Qualifications: Bech. Degree of administration science, (MBA) preferable Competencies: at least 10 years experience in hr field in a big projects Ability to lead and communicate with others Fluent in English read and written
  • 14.
    Human Resource Plan(Output) HR plan includes (but not limited to) 1. Roles and responsibilities • Role • Authority • Responsibility • Competency 2. Project Organization Chart 3. Staffing Management Plan • Staff Acquisition • Resource calendars • Staff release plan • Training needs • Recognition and rewards • Compliance, Safety. • Resource Histogram Bar chart shows number of resource used per time period
  • 15.
    HUMAN RESOURCE PLAN ProjectTitle: Date Prepared: Roles, Responsibilities, and Authority: Role: Authority: Responsibility: 1. Defines the role or job title. 1. Defines decision making limits. 1. Defines the duties. 2. Project Organizational Structure: Insert an organizational chart for the project. May include an organizational chart of the enterprise and how the project fits within the enterprise.
  • 16.
    HUMAN RESOURCE PLAN StaffingManagement Plan Staff Acquisition: Describes how staff will be brought on to the project. Defines any differences between internal staff team members and outsourced team members with regards to on boarding procedures. Staff Release: Describes how team members will be released from the team, including knowledge transfer, and check out procedures for staff and outsourced team members. Resource Calendars: Shows any unusual resource calendars such as abbreviated work weeks, vacations, and time constraints for team members that are less than full time. Training Needs: Describes any required training on equipment, technology or company processes. Rewards and Recognition: Describes any reward and recognition processes or limitations. Regulations, Standards, and Policy Compliance: All team must comply with company rules Safety: There are safety plan in site approved by OSHA
  • 17.
    HUMAN RESOURCE PLAN ProjectTitle: Constructing private hospital Date Prepared: 23/11/2012 Roles, Responsibilities, and Authority: Role: Authority: Responsibility: 1. Project Manager . 1. Have authority to accomplish project management work. 2. Have authority to approve change request 1. responsible for the overall success of the Project Project Organizational Structure: .
  • 18.
    HUMAN RESOURCE PLAN StaffingManagement Plan Staff Acquisition: Staff are acquired from organization and the remaining jobs can we make interview to acquire project team some jobs are acquired by subcontractors Staff Release: Every employee know the date of release after finishing his roles in project Resource Calendars: 5 days in weak Friday and Saturday (vacation) 8 hrs in day. Training Needs: Trainning plan include onshore and offshore training. Rewards and Recognition: The company will provide free family movie tickets for the top two performers on project. Regulations, Standards, and Policy Compliance: Safety: Describes any safety regulations, equipment, training, or procedures.
  • 19.
    Acquire Project Team •The process of confirming human resource availability and obtain the team necessary to complete project assignments. Inputs 1. Project management plan 2. Enterprise environmental factors 3. Organizational process assets Tools & Techniques 1. Pre-assignment 2. Negotiation 3. Acquisition 4. Virtual teams Outputs 1. Project staff assignment 2. Resource calendars 3. Project management plan updates
  • 20.
    Pre assignment When projectteam members are selected in advance they are considered pre-assigned. - if the project is dependent upon the expertise of particular persons, or if some staff assignments are defined within the project charter
  • 21.
    Negotiation • negotiate with: -Functional managers to ensure that the project receives appropriately competent staff in the required time frame - Performing organization resource or specialized human resources
  • 22.
    Acquisition • When theperforming organization lacks the in-house staff needed to complete a project, the required services may be acquired from outside sources. This can involve hiring individual consultants or subcontracting work
  • 23.
    Virtual Teams - groupsof people with a shared goal not meeting face to face - Add special expertise from different countries - Communication planning becomes increasingly important
  • 24.
    Project Staff Assignments -people have been assigned through the previously described methods. - The documentation include a project team directory, memos to team members, and names
  • 25.
  • 26.
    1-You are newlyappointed as a project manager of an ongoing project. You want to see the role, authority, responsibility and competencies of all the resources working in the project. Which of the following document lists all the above information? 1.Scope statement 2.Project Charter 3.Human Resource Plan 4.WBS
  • 27.
    2- Resource BreakdownStructure is an example of: 1-Hierarchical-type Organizational Chart 2-Responsibility Assignment Matrix 3-Text-oriented Format 4-Functional Chart
  • 28.
    3- All ofthe following can be used to document team member roles and responsibilities EXCEPT: 1-Hierarchical-type Organizational Chart 2-Matrix-based Responsibility Chart 3-Text-oriented Format 4-Functional Chart
  • 29.
    4-Which of thefollowing best describe what is included in a staffing management plan? A- a plan regarding what details about the project should go to whom and when the details need to be sent. B- how the team will implement plans for ensuring the project will satisfy the needs which it was undertaken C. when and how human resource will be brought into and taken off the project team D-if independent estimates are needed who will prepare them and when
  • 30.
    5-in creating aproject management plan, how should a project manager use rewards A- use the reward system currently in place throughout the company B- ignore rewards because the functional manager will take care of it C- create a specific reward system for the project D- ignore rewards because they are managements responsibility
  • 31.
    •6- Which ofthe following is the most important element of Project Management Plan that is useful in HR Planning process: A.Risk Management activities B.Quality Assurance activities C.Activity Resource requirements D.Budget Control activities
  • 32.
    7-Which of thefollowing is not true for a Responsibility Assignment Matrix (RAM) A.Defines what project team is responsible for each WBS component B.Defines what project member is responsible for each activity C.Text description of roles, responsibilities, authorities D.Defines all people associated with each activity
  • 33.
    8-Which chart allowsa project manager to indicate the number of resources used each month? • A- Responsibility Assignment Matrix • B-Resource histogram • C-project organizational chart • D- pareto chart
  • 34.
