PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
0. Introduction
1. Plan Cost Management
2. Estimate Costs
3. Determine Budget
4. Control Costs
Lecture 07 : Project Cost Management (1/18)
Contents
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Lecture 07 : Project Cost Management (2/18)
Introduction
Direct vs. Indirect Cost
1. Direct Cost: Directly attributable to project work. ‫المشروع‬ ‫بأعمال‬ ‫مباشرة‬ ‫تتأثر‬
2. Indirect cost: Such as overhead, benefits, and costs incurred for more than
project like equipments. ‫المشاريع‬ ‫بين‬ ‫المشتركة‬ ‫التكاليف‬ ‫و‬ ‫االرباح‬ ‫و‬ ‫العامة‬ ‫النفقات‬ ‫مثل‬
Fixed vs. Variable Cost
1. Fixed cost: Costs that are not changed with production such as setup cost
and rental cost ‫االنتاج‬ ‫مع‬ ‫تتغير‬ ‫ال‬ ‫تكاليف‬
2. Variable cost: Costs that are changed with production such as material and
labors. ‫الخام‬ ‫المواد‬ ‫و‬ ‫العمالة‬ ‫تكاليف‬ ‫مثل‬ ‫االنتاج‬ ‫مع‬ ‫تتغير‬ ‫التي‬ ‫التكاليف‬
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Lecture 07 : Project Cost Management (3/18)
Introduction
Definitions :

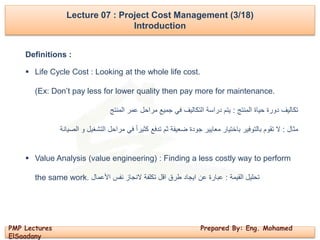

 Life Cycle Cost : Looking at the whole life cost.
(Ex: Don’t pay less for lower quality then pay more for maintenance.
‫المنتج‬ ‫حياة‬ ‫دورة‬ ‫تكاليف‬:‫المنتج‬ ‫عمر‬ ‫مراحل‬ ‫جميع‬ ‫في‬ ‫التكاليف‬ ‫دراسة‬ ‫يتم‬
‫مثال‬:‫الصيانة‬ ‫و‬ ‫التشغيل‬ ‫مراحل‬ ‫في‬ ً‫ا‬‫كثير‬ ‫تدفع‬ ‫ثم‬ ‫ضعيفة‬ ‫جودة‬ ‫معايير‬ ‫باختيار‬ ‫بالتوفير‬ ‫تقوم‬ ‫ال‬
 Value Analysis (value engineering) : Finding a less costly way to perform
the same work. ‫القيمة‬ ‫تحليل‬:‫األعمال‬ ‫نفس‬ ‫النجاز‬ ‫تكلفة‬ ‫اقل‬ ‫طرق‬ ‫ايجاد‬ ‫عن‬ ‫عبارة‬
Lecture 07 : Project Cost Management (4/18)
1.Plan Cost Management (Planning)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
C o s t M a n a g e m e n t
7.1 Plan Cost Management
Inputs :
 Project Management Plan
 Project Charter
 Enterprise Environmental Factors
 Organizational Process Assets
Tools and Techniques :
 Expert Judgment
 Analytical Techniques
 Meetings
Outputs :
 Cost Management Plan
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany

Analytical Techniques
• Strategic options to fund the project
o Self-funding,
o Funding with equity, (Ex: Stocks) ‫التمويل‬‫خالل‬ ‫من‬‫باألسهم‬ ‫كما‬ ‫المشاركة‬
o Funding with debt (Ex: Bonds) ‫بالسندات‬ ‫كما‬ ‫االقتراض‬ ‫خالل‬ ‫من‬ ‫التمويل‬
• Project resources Finance
o Making,
o Purchasing,
o Renting (Short Term),
o Leasing (Long Term).
• Financial analysis techniques:
o payback period,
o Return on investment (value),
o Internal rate of return,
o Net present value.
Lecture 07 : Project Cost Management (5/18)
1.Plan Cost Management (Planning)
TT
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany

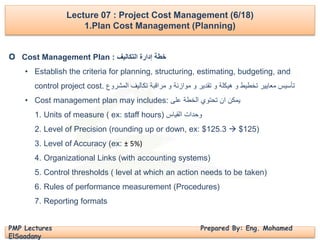

Cost Management Plan : ‫التكاليف‬ ‫إدارة‬ ‫خطة‬
• Establish the criteria for planning, structuring, estimating, budgeting, and
control project cost. ‫المشروع‬ ‫تكاليف‬ ‫مراقبة‬ ‫و‬ ‫موازنة‬ ‫و‬ ‫تقدير‬ ‫و‬ ‫هيكلة‬ ‫و‬ ‫تخطيط‬ ‫معايير‬ ‫تأسيس‬
• Cost management plan may includes: ‫على‬ ‫الخطة‬ ‫تحتوي‬ ‫ان‬ ‫يمكن‬
1. Units of measure ( ex: staff hours) ‫القياس‬ ‫وحدات‬
2. Level of Precision (rounding up or down, ex: $125.3  $125)
3. Level of Accuracy (ex: ± 5%)
4. Organizational Links (with accounting systems)
5. Control thresholds ( level at which an action needs to be taken)
6. Rules of performance measurement (Procedures)
7. Reporting formats
Lecture 07 : Project Cost Management (6/18)
1.Plan Cost Management (Planning)
O
Lecture 07 : Project Cost Management (7/18)
2.Estimate Costs (Planning)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
C o s t M a n a g e m e n t
7 . 2 E s t i m a t e C o s t s
Inputs :
 Cost Management Plan ■ Scope Baseline
 Human Resource Management Plan ■ Project Schedule
 Risk Register ■ Enterprise Environmental Factors
 Organizational Process Assets
Tools and Techniques :
 Expert Judgment ■ Analogous Estimating
 Parametric Estimating ■ Bottom-Up Estimating
 Three-Point Estimates ■ Reserve Analysis
 Cost of Quality ■ Project Management Software
 Group Decision-Making Techniques ■ Vendor Bid Analysis
Outputs :
 Activity Cost Estimates
 Basis of Estimates
 Project Document Updates
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Lecture 07 : Project Cost Management (8/18)
2.Estimate Costs (Planning)

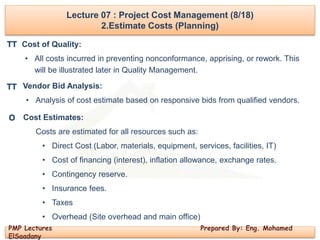

Cost of Quality:
• All costs incurred in preventing nonconformance, apprising, or rework. This
will be illustrated later in Quality Management.
Vendor Bid Analysis:
• Analysis of cost estimate based on responsive bids from qualified vendors.
Cost Estimates:
Costs are estimated for all resources such as:
• Direct Cost (Labor, materials, equipment, services, facilities, IT)
• Cost of financing (interest), inflation allowance, exchange rates.
• Contingency reserve.
• Insurance fees.
• Taxes
• Overhead (Site overhead and main office)
TT
O
TT
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Lecture 07 : Project Cost Management (9/18)
2.Estimate Costs (Planning)
Basis of Estimates :
• Supporting documentation which provides understanding of how the cost
estimate was derived.
• This may includes:
• Assumptions.
• Constraints.
• Ranges of accuracy (ex:± 5%).
• Confidence level of the final cost estimate.
O
Lecture 07 : Project Cost Management (10/18)
3.Determine Budget (Planning)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
C o s t M a n a g e m e n t
7 . 3 D e t e r m i n e B u d g e t
Inputs :
 Cost Management Plan ■ Scope Baseline
 Activity Cost Estimates ■ Basis of Estimates
 Project Schedule ■ Resource Calendars
 Risk Register ■ Agreements
 Organizational Process Assets
Tools and Techniques :
 Cost Aggregation
 Reserve Analysis
 Expert Judgment
 Historical Relationships
 Funding Limit Reconciliation ‫توفيق‬
Outputs :
 Cost Baseline
 Project Funding Requirements
 Project Document Updates
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Lecture 07 : Project Cost Management (11/18)
3.Determine Budget (Planning)

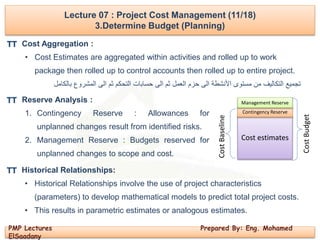

Cost Aggregation :
• Cost Estimates are aggregated within activities and rolled up to work
package then rolled up to control accounts then rolled up to entire project.
‫بالكامل‬ ‫المشروع‬ ‫الى‬ ‫ثم‬ ‫التحكم‬ ‫حسابات‬ ‫الى‬ ‫ثم‬ ‫العمل‬ ‫حزم‬ ‫الى‬ ‫األنشطة‬ ‫مستوى‬ ‫من‬ ‫التكاليف‬ ‫تجميع‬
Reserve Analysis :
1. Contingency Reserve : Allowances for
unplanned changes result from identified risks.
2. Management Reserve : Budgets reserved for
unplanned changes to scope and cost.
Cost estimates
Contingency Reserve
Management Reserve
CostBudget
CostBaseline
TT
TT
Historical Relationships:
• Historical Relationships involve the use of project characteristics
(parameters) to develop mathematical models to predict total project costs.
• This results in parametric estimates or analogous estimates.
TT
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Lecture 07 : Project Cost Management (12/18)
3.Determine Budget (Planning)

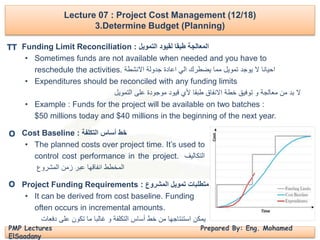

Funding Limit Reconciliation : ‫التمويل‬ ‫لقيود‬ ‫طبقا‬ ‫المعالجة‬
• Sometimes funds are not available when needed and you have to
reschedule the activities. ‫االنشطة‬ ‫جدولة‬ ‫اعادة‬ ‫الي‬ ‫يضطرك‬ ‫مما‬ ‫تمويل‬ ‫يوجد‬ ‫ال‬ ‫احيانا‬
• Expenditures should be reconciled with any funding limits
‫التمويل‬ ‫على‬ ‫موجودة‬ ‫قيود‬ ‫ألي‬ ‫طبقا‬ ‫االنفاق‬ ‫خطة‬ ‫توفيق‬ ‫و‬ ‫معالجة‬ ‫من‬ ‫بد‬ ‫ال‬
• Example : Funds for the project will be available on two batches :
$50 millions today and $40 millions in the beginning of the next year.
Cost Baseline : ‫التكلفة‬ ‫أساس‬ ‫خط‬
• The planned costs over project time. It’s used to
control cost performance in the project. ‫التكاليف‬
‫المخطط‬‫انفاقها‬‫عبر‬‫زمن‬‫المشروع‬
Project Funding Requirements : ‫المشروع‬ ‫تمويل‬ ‫متطلبات‬
• It can be derived from cost baseline. Funding
often occurs in incremental amounts.
‫دفعات‬ ‫على‬ ‫تكون‬ ‫ما‬ ‫غالبا‬ ‫و‬ ‫التكلفة‬ ‫أساس‬ ‫خط‬ ‫من‬ ‫استنتاجها‬ ‫يمكن‬
TT
O
O
Lecture 07 : Project Cost Management (13/18)
4.Control Costs (M/C)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
C o s t M a n a g e m e n t
7 . 4 C o n t r o l C o s t s

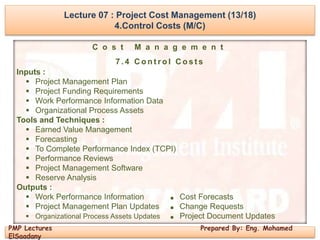

Inputs :
 Project Management Plan
 Project Funding Requirements
 Work Performance Information Data
 Organizational Process Assets
Tools and Techniques :
 Earned Value Management
 Forecasting
 To Complete Performance Index (TCPI)
 Performance Reviews
 Project Management Software
 Reserve Analysis
Outputs :
 Work Performance Information ■ Cost Forecasts
 Project Management Plan Updates ■ Change Requests
 Organizational Process Assets Updates ■ Project Document Updates
Lecture 07 : Project Cost Management (14/18)
4.Control Costs (M/C)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany

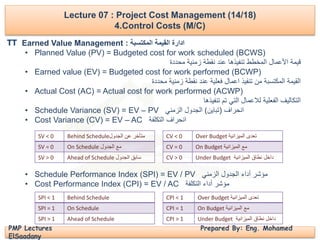

Earned Value Management : ‫المكتسبة‬ ‫القيمة‬ ‫ادارة‬
• Planned Value (PV) = Budgeted cost for work scheduled (BCWS)
‫محددة‬ ‫زمنية‬ ‫نقطة‬ ‫عند‬ ‫تنفيذها‬ ‫المخطط‬ ‫األعمال‬ ‫قيمة‬
• Earned value (EV) = Budgeted cost for work performed (BCWP)
‫محددة‬ ‫زمنية‬ ‫نقطة‬ ‫عند‬ ‫فعلية‬ ‫اعمال‬ ‫تنفيذ‬ ‫من‬ ‫المكتسبة‬ ‫القيمة‬
• Actual Cost (AC) = Actual cost for work performed (ACWP)
‫تنفيذها‬ ‫تم‬ ‫التي‬ ‫لالعمال‬ ‫الفعلية‬ ‫التكاليف‬
• Schedule Variance (SV) = EV – PV ‫انحراف‬(‫تباين‬)‫الزمني‬ ‫الجدول‬
• Cost Variance (CV) = EV – AC ‫التكلفة‬ ‫انحراف‬
• Schedule Performance Index (SPI) = EV / PV ‫الزمني‬ ‫الجدول‬ ‫أداء‬ ‫مؤشر‬
• Cost Performance Index (CPI) = EV / AC ‫التكلفة‬ ‫أداء‬ ‫مؤشر‬
Behind Schedule ‫متأخر‬‫الجدول‬ ‫عن‬SV < 0
On Schedule ‫الجدول‬ ‫مع‬SV = 0
Ahead of Schedule ‫الجدول‬ ‫سابق‬SV > 0
Over Budget ‫الميزانية‬ ‫تعدى‬CV < 0
On Budget ‫الميزانية‬ ‫مع‬CV = 0
Under Budget ‫الميزانية‬ ‫نطاق‬ ‫داخل‬CV > 0
Behind ScheduleSPI < 1
On ScheduleSPI = 1
Ahead of ScheduleSPI > 1
Over Budget ‫الميزانية‬ ‫تعدى‬CPI < 1
On Budget ‫الميزانية‬ ‫مع‬CPI = 1
Under Budget ‫الميزانية‬ ‫نطاق‬ ‫داخل‬CPI > 1
TT
Lecture 07 : Project Cost Management (15/18)
4.Control Costs (M/C)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Example :
PV (BCWS) =1000x120 = 120,000.00
EV (BCWP) =1000x130 = 130,000.00
AC (ACWP) =1200*130 = 156,000.00
Variance :
SV = EV - PV = 130'000 - 120'000 = 10'000 (Ahead of Schedule)
CV = EV - AC = 130'000 - 156'000 = -26'000 (Over Budget)
Performance Index
SPI = EV / PV = 130'000 / 120'000 = 1.083 (Ahead of Schedule)
CVI = EV / AC = 130'000 / 156'000 = 0.833 (Over Budget)
Cost/Unit Quantity
Budget 1000 120
Actual 1200 130
Lecture 07 : Project Cost Management (16/18)
4.Control Costs (M/C)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Time
Cost
Lecture 07 : Project Cost Management (17/18)
4.Control Costs (M/C)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
Forecasting : ‫معايير‬ ‫خالل‬ ‫من‬ ‫التوقع‬
• Estimate at Completion (EAC) = Actual Cost+ Estimate to Complete (ETC).
‫المشروع‬ ‫نهاية‬ ‫في‬ ‫المتوقعة‬ ‫القيمة‬=‫اآلن‬ ‫حتى‬ ‫الفعلية‬ ‫القيمة‬+‫المشروع‬ ‫النهاء‬ ‫المتوقع‬
• There are various methods to calculate the Estimate to Complete (ETC)
‫المشروع‬ ‫النهاء‬ ‫المتوقعة‬ ‫القيمة‬ ‫لحساب‬ ‫طرق‬ ‫عدة‬ ‫يوجد‬
1- At the budgeted rate :
EAC = AC + (BAC – EV)
2- Considering CPI :
EAC = AC + [ (BAC – EV) / CPI ] = AC + BAC/CPI – EV/CPI
= AC + BAC/CPI – AC = BAC / CPI
3- Considering CPI and SPI :
EAC = AC + [ (BAC – EV) / (CPI x SPI) ]
TT
Lecture 07 : Project Cost Management (18/18)
4.Control Costs (M/C)
PMP Lectures Prepared By: Eng. Mohamed
ElSaadany
To Complete Performance Index (TCPI) : ‫المشروع‬ ‫إلكمال‬ ‫المطلوبة‬ ‫للقيمة‬ ‫اآلداء‬ ‫مؤشر‬
• It’s the cost performance that must be achieved on the remaining work to
meet a specified goal like BAC or EAC ‫القادمة‬ ‫الفترة‬ ‫في‬ ‫تحقيقه‬ ‫المطلوب‬ ‫المالي‬ ‫االداء‬
• It represents the ratio between remaining works and remaining funds.
‫المتبقي‬ ‫التمويل‬ ‫قيمة‬ ‫و‬ ‫المتبقية‬ ‫االعمال‬ ‫قيمة‬ ‫بين‬ ‫النسبة‬ ‫تمثل‬
• TCPI = (BAC-EV) / (BAC – AC)
Or TCPI = (BAC-EV) / (EAC – AC) “If the BAC is no longer valid”
• Ex :
BAC = 500’000.00 , EV = 200’000.00, AC= 250’000.00
TCPI = (300’000.00 ) / (250’000.00) = 1.2
TT
Performance Reviews :
• Variance at completion (VAC) = BAC – EAC
• Trend Analysis: Graphical analysis examines project performance over time.
• EVM
TT

PMP Preparation - 07 Cost Management

  • 1.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany 0. Introduction 1. Plan Cost Management 2. Estimate Costs 3. Determine Budget 4. Control Costs Lecture 07 : Project Cost Management (1/18) Contents
  • 2.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany Lecture 07 : Project Cost Management (2/18) Introduction Direct vs. Indirect Cost 1. Direct Cost: Directly attributable to project work. ‫المشروع‬ ‫بأعمال‬ ‫مباشرة‬ ‫تتأثر‬ 2. Indirect cost: Such as overhead, benefits, and costs incurred for more than project like equipments. ‫المشاريع‬ ‫بين‬ ‫المشتركة‬ ‫التكاليف‬ ‫و‬ ‫االرباح‬ ‫و‬ ‫العامة‬ ‫النفقات‬ ‫مثل‬ Fixed vs. Variable Cost 1. Fixed cost: Costs that are not changed with production such as setup cost and rental cost ‫االنتاج‬ ‫مع‬ ‫تتغير‬ ‫ال‬ ‫تكاليف‬ 2. Variable cost: Costs that are changed with production such as material and labors. ‫الخام‬ ‫المواد‬ ‫و‬ ‫العمالة‬ ‫تكاليف‬ ‫مثل‬ ‫االنتاج‬ ‫مع‬ ‫تتغير‬ ‫التي‬ ‫التكاليف‬
  • 3.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany Lecture 07 : Project Cost Management (3/18) Introduction Definitions :  Life Cycle Cost : Looking at the whole life cost. (Ex: Don’t pay less for lower quality then pay more for maintenance. ‫المنتج‬ ‫حياة‬ ‫دورة‬ ‫تكاليف‬:‫المنتج‬ ‫عمر‬ ‫مراحل‬ ‫جميع‬ ‫في‬ ‫التكاليف‬ ‫دراسة‬ ‫يتم‬ ‫مثال‬:‫الصيانة‬ ‫و‬ ‫التشغيل‬ ‫مراحل‬ ‫في‬ ً‫ا‬‫كثير‬ ‫تدفع‬ ‫ثم‬ ‫ضعيفة‬ ‫جودة‬ ‫معايير‬ ‫باختيار‬ ‫بالتوفير‬ ‫تقوم‬ ‫ال‬  Value Analysis (value engineering) : Finding a less costly way to perform the same work. ‫القيمة‬ ‫تحليل‬:‫األعمال‬ ‫نفس‬ ‫النجاز‬ ‫تكلفة‬ ‫اقل‬ ‫طرق‬ ‫ايجاد‬ ‫عن‬ ‫عبارة‬
  • 4.
    Lecture 07 :Project Cost Management (4/18) 1.Plan Cost Management (Planning) PMP Lectures Prepared By: Eng. Mohamed ElSaadany C o s t M a n a g e m e n t 7.1 Plan Cost Management Inputs :  Project Management Plan  Project Charter  Enterprise Environmental Factors  Organizational Process Assets Tools and Techniques :  Expert Judgment  Analytical Techniques  Meetings Outputs :  Cost Management Plan
  • 5.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany Analytical Techniques • Strategic options to fund the project o Self-funding, o Funding with equity, (Ex: Stocks) ‫التمويل‬‫خالل‬ ‫من‬‫باألسهم‬ ‫كما‬ ‫المشاركة‬ o Funding with debt (Ex: Bonds) ‫بالسندات‬ ‫كما‬ ‫االقتراض‬ ‫خالل‬ ‫من‬ ‫التمويل‬ • Project resources Finance o Making, o Purchasing, o Renting (Short Term), o Leasing (Long Term). • Financial analysis techniques: o payback period, o Return on investment (value), o Internal rate of return, o Net present value. Lecture 07 : Project Cost Management (5/18) 1.Plan Cost Management (Planning) TT
  • 6.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany Cost Management Plan : ‫التكاليف‬ ‫إدارة‬ ‫خطة‬ • Establish the criteria for planning, structuring, estimating, budgeting, and control project cost. ‫المشروع‬ ‫تكاليف‬ ‫مراقبة‬ ‫و‬ ‫موازنة‬ ‫و‬ ‫تقدير‬ ‫و‬ ‫هيكلة‬ ‫و‬ ‫تخطيط‬ ‫معايير‬ ‫تأسيس‬ • Cost management plan may includes: ‫على‬ ‫الخطة‬ ‫تحتوي‬ ‫ان‬ ‫يمكن‬ 1. Units of measure ( ex: staff hours) ‫القياس‬ ‫وحدات‬ 2. Level of Precision (rounding up or down, ex: $125.3  $125) 3. Level of Accuracy (ex: ± 5%) 4. Organizational Links (with accounting systems) 5. Control thresholds ( level at which an action needs to be taken) 6. Rules of performance measurement (Procedures) 7. Reporting formats Lecture 07 : Project Cost Management (6/18) 1.Plan Cost Management (Planning) O
  • 7.
    Lecture 07 :Project Cost Management (7/18) 2.Estimate Costs (Planning) PMP Lectures Prepared By: Eng. Mohamed ElSaadany C o s t M a n a g e m e n t 7 . 2 E s t i m a t e C o s t s Inputs :  Cost Management Plan ■ Scope Baseline  Human Resource Management Plan ■ Project Schedule  Risk Register ■ Enterprise Environmental Factors  Organizational Process Assets Tools and Techniques :  Expert Judgment ■ Analogous Estimating  Parametric Estimating ■ Bottom-Up Estimating  Three-Point Estimates ■ Reserve Analysis  Cost of Quality ■ Project Management Software  Group Decision-Making Techniques ■ Vendor Bid Analysis Outputs :  Activity Cost Estimates  Basis of Estimates  Project Document Updates
  • 8.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany Lecture 07 : Project Cost Management (8/18) 2.Estimate Costs (Planning) Cost of Quality: • All costs incurred in preventing nonconformance, apprising, or rework. This will be illustrated later in Quality Management. Vendor Bid Analysis: • Analysis of cost estimate based on responsive bids from qualified vendors. Cost Estimates: Costs are estimated for all resources such as: • Direct Cost (Labor, materials, equipment, services, facilities, IT) • Cost of financing (interest), inflation allowance, exchange rates. • Contingency reserve. • Insurance fees. • Taxes • Overhead (Site overhead and main office) TT O TT
  • 9.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany Lecture 07 : Project Cost Management (9/18) 2.Estimate Costs (Planning) Basis of Estimates : • Supporting documentation which provides understanding of how the cost estimate was derived. • This may includes: • Assumptions. • Constraints. • Ranges of accuracy (ex:± 5%). • Confidence level of the final cost estimate. O
  • 10.
    Lecture 07 :Project Cost Management (10/18) 3.Determine Budget (Planning) PMP Lectures Prepared By: Eng. Mohamed ElSaadany C o s t M a n a g e m e n t 7 . 3 D e t e r m i n e B u d g e t Inputs :  Cost Management Plan ■ Scope Baseline  Activity Cost Estimates ■ Basis of Estimates  Project Schedule ■ Resource Calendars  Risk Register ■ Agreements  Organizational Process Assets Tools and Techniques :  Cost Aggregation  Reserve Analysis  Expert Judgment  Historical Relationships  Funding Limit Reconciliation ‫توفيق‬ Outputs :  Cost Baseline  Project Funding Requirements  Project Document Updates
  • 11.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany Lecture 07 : Project Cost Management (11/18) 3.Determine Budget (Planning) Cost Aggregation : • Cost Estimates are aggregated within activities and rolled up to work package then rolled up to control accounts then rolled up to entire project. ‫بالكامل‬ ‫المشروع‬ ‫الى‬ ‫ثم‬ ‫التحكم‬ ‫حسابات‬ ‫الى‬ ‫ثم‬ ‫العمل‬ ‫حزم‬ ‫الى‬ ‫األنشطة‬ ‫مستوى‬ ‫من‬ ‫التكاليف‬ ‫تجميع‬ Reserve Analysis : 1. Contingency Reserve : Allowances for unplanned changes result from identified risks. 2. Management Reserve : Budgets reserved for unplanned changes to scope and cost. Cost estimates Contingency Reserve Management Reserve CostBudget CostBaseline TT TT Historical Relationships: • Historical Relationships involve the use of project characteristics (parameters) to develop mathematical models to predict total project costs. • This results in parametric estimates or analogous estimates. TT
  • 12.
    PMP Lectures PreparedBy: Eng. Mohamed ElSaadany Lecture 07 : Project Cost Management (12/18) 3.Determine Budget (Planning) Funding Limit Reconciliation : ‫التمويل‬ ‫لقيود‬ ‫طبقا‬ ‫المعالجة‬ • Sometimes funds are not available when needed and you have to reschedule the activities. ‫االنشطة‬ ‫جدولة‬ ‫اعادة‬ ‫الي‬ ‫يضطرك‬ ‫مما‬ ‫تمويل‬ ‫يوجد‬ ‫ال‬ ‫احيانا‬ • Expenditures should be reconciled with any funding limits ‫التمويل‬ ‫على‬ ‫موجودة‬ ‫قيود‬ ‫ألي‬ ‫طبقا‬ ‫االنفاق‬ ‫خطة‬ ‫توفيق‬ ‫و‬ ‫معالجة‬ ‫من‬ ‫بد‬ ‫ال‬ • Example : Funds for the project will be available on two batches : $50 millions today and $40 millions in the beginning of the next year. Cost Baseline : ‫التكلفة‬ ‫أساس‬ ‫خط‬ • The planned costs over project time. It’s used to control cost performance in the project. ‫التكاليف‬ ‫المخطط‬‫انفاقها‬‫عبر‬‫زمن‬‫المشروع‬ Project Funding Requirements : ‫المشروع‬ ‫تمويل‬ ‫متطلبات‬ • It can be derived from cost baseline. Funding often occurs in incremental amounts. ‫دفعات‬ ‫على‬ ‫تكون‬ ‫ما‬ ‫غالبا‬ ‫و‬ ‫التكلفة‬ ‫أساس‬ ‫خط‬ ‫من‬ ‫استنتاجها‬ ‫يمكن‬ TT O O
  • 13.
    Lecture 07 :Project Cost Management (13/18) 4.Control Costs (M/C) PMP Lectures Prepared By: Eng. Mohamed ElSaadany C o s t M a n a g e m e n t 7 . 4 C o n t r o l C o s t s Inputs :  Project Management Plan  Project Funding Requirements  Work Performance Information Data  Organizational Process Assets Tools and Techniques :  Earned Value Management  Forecasting  To Complete Performance Index (TCPI)  Performance Reviews  Project Management Software  Reserve Analysis Outputs :  Work Performance Information ■ Cost Forecasts  Project Management Plan Updates ■ Change Requests  Organizational Process Assets Updates ■ Project Document Updates
  • 14.
    Lecture 07 :Project Cost Management (14/18) 4.Control Costs (M/C) PMP Lectures Prepared By: Eng. Mohamed ElSaadany Earned Value Management : ‫المكتسبة‬ ‫القيمة‬ ‫ادارة‬ • Planned Value (PV) = Budgeted cost for work scheduled (BCWS) ‫محددة‬ ‫زمنية‬ ‫نقطة‬ ‫عند‬ ‫تنفيذها‬ ‫المخطط‬ ‫األعمال‬ ‫قيمة‬ • Earned value (EV) = Budgeted cost for work performed (BCWP) ‫محددة‬ ‫زمنية‬ ‫نقطة‬ ‫عند‬ ‫فعلية‬ ‫اعمال‬ ‫تنفيذ‬ ‫من‬ ‫المكتسبة‬ ‫القيمة‬ • Actual Cost (AC) = Actual cost for work performed (ACWP) ‫تنفيذها‬ ‫تم‬ ‫التي‬ ‫لالعمال‬ ‫الفعلية‬ ‫التكاليف‬ • Schedule Variance (SV) = EV – PV ‫انحراف‬(‫تباين‬)‫الزمني‬ ‫الجدول‬ • Cost Variance (CV) = EV – AC ‫التكلفة‬ ‫انحراف‬ • Schedule Performance Index (SPI) = EV / PV ‫الزمني‬ ‫الجدول‬ ‫أداء‬ ‫مؤشر‬ • Cost Performance Index (CPI) = EV / AC ‫التكلفة‬ ‫أداء‬ ‫مؤشر‬ Behind Schedule ‫متأخر‬‫الجدول‬ ‫عن‬SV < 0 On Schedule ‫الجدول‬ ‫مع‬SV = 0 Ahead of Schedule ‫الجدول‬ ‫سابق‬SV > 0 Over Budget ‫الميزانية‬ ‫تعدى‬CV < 0 On Budget ‫الميزانية‬ ‫مع‬CV = 0 Under Budget ‫الميزانية‬ ‫نطاق‬ ‫داخل‬CV > 0 Behind ScheduleSPI < 1 On ScheduleSPI = 1 Ahead of ScheduleSPI > 1 Over Budget ‫الميزانية‬ ‫تعدى‬CPI < 1 On Budget ‫الميزانية‬ ‫مع‬CPI = 1 Under Budget ‫الميزانية‬ ‫نطاق‬ ‫داخل‬CPI > 1 TT
  • 15.
    Lecture 07 :Project Cost Management (15/18) 4.Control Costs (M/C) PMP Lectures Prepared By: Eng. Mohamed ElSaadany Example : PV (BCWS) =1000x120 = 120,000.00 EV (BCWP) =1000x130 = 130,000.00 AC (ACWP) =1200*130 = 156,000.00 Variance : SV = EV - PV = 130'000 - 120'000 = 10'000 (Ahead of Schedule) CV = EV - AC = 130'000 - 156'000 = -26'000 (Over Budget) Performance Index SPI = EV / PV = 130'000 / 120'000 = 1.083 (Ahead of Schedule) CVI = EV / AC = 130'000 / 156'000 = 0.833 (Over Budget) Cost/Unit Quantity Budget 1000 120 Actual 1200 130
  • 16.
    Lecture 07 :Project Cost Management (16/18) 4.Control Costs (M/C) PMP Lectures Prepared By: Eng. Mohamed ElSaadany Time Cost
  • 17.
    Lecture 07 :Project Cost Management (17/18) 4.Control Costs (M/C) PMP Lectures Prepared By: Eng. Mohamed ElSaadany Forecasting : ‫معايير‬ ‫خالل‬ ‫من‬ ‫التوقع‬ • Estimate at Completion (EAC) = Actual Cost+ Estimate to Complete (ETC). ‫المشروع‬ ‫نهاية‬ ‫في‬ ‫المتوقعة‬ ‫القيمة‬=‫اآلن‬ ‫حتى‬ ‫الفعلية‬ ‫القيمة‬+‫المشروع‬ ‫النهاء‬ ‫المتوقع‬ • There are various methods to calculate the Estimate to Complete (ETC) ‫المشروع‬ ‫النهاء‬ ‫المتوقعة‬ ‫القيمة‬ ‫لحساب‬ ‫طرق‬ ‫عدة‬ ‫يوجد‬ 1- At the budgeted rate : EAC = AC + (BAC – EV) 2- Considering CPI : EAC = AC + [ (BAC – EV) / CPI ] = AC + BAC/CPI – EV/CPI = AC + BAC/CPI – AC = BAC / CPI 3- Considering CPI and SPI : EAC = AC + [ (BAC – EV) / (CPI x SPI) ] TT
  • 18.
    Lecture 07 :Project Cost Management (18/18) 4.Control Costs (M/C) PMP Lectures Prepared By: Eng. Mohamed ElSaadany To Complete Performance Index (TCPI) : ‫المشروع‬ ‫إلكمال‬ ‫المطلوبة‬ ‫للقيمة‬ ‫اآلداء‬ ‫مؤشر‬ • It’s the cost performance that must be achieved on the remaining work to meet a specified goal like BAC or EAC ‫القادمة‬ ‫الفترة‬ ‫في‬ ‫تحقيقه‬ ‫المطلوب‬ ‫المالي‬ ‫االداء‬ • It represents the ratio between remaining works and remaining funds. ‫المتبقي‬ ‫التمويل‬ ‫قيمة‬ ‫و‬ ‫المتبقية‬ ‫االعمال‬ ‫قيمة‬ ‫بين‬ ‫النسبة‬ ‫تمثل‬ • TCPI = (BAC-EV) / (BAC – AC) Or TCPI = (BAC-EV) / (EAC – AC) “If the BAC is no longer valid” • Ex : BAC = 500’000.00 , EV = 200’000.00, AC= 250’000.00 TCPI = (300’000.00 ) / (250’000.00) = 1.2 TT Performance Reviews : • Variance at completion (VAC) = BAC – EAC • Trend Analysis: Graphical analysis examines project performance over time. • EVM TT
