Connoisseur Solutions
Project Integration Management
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Project Integration Management

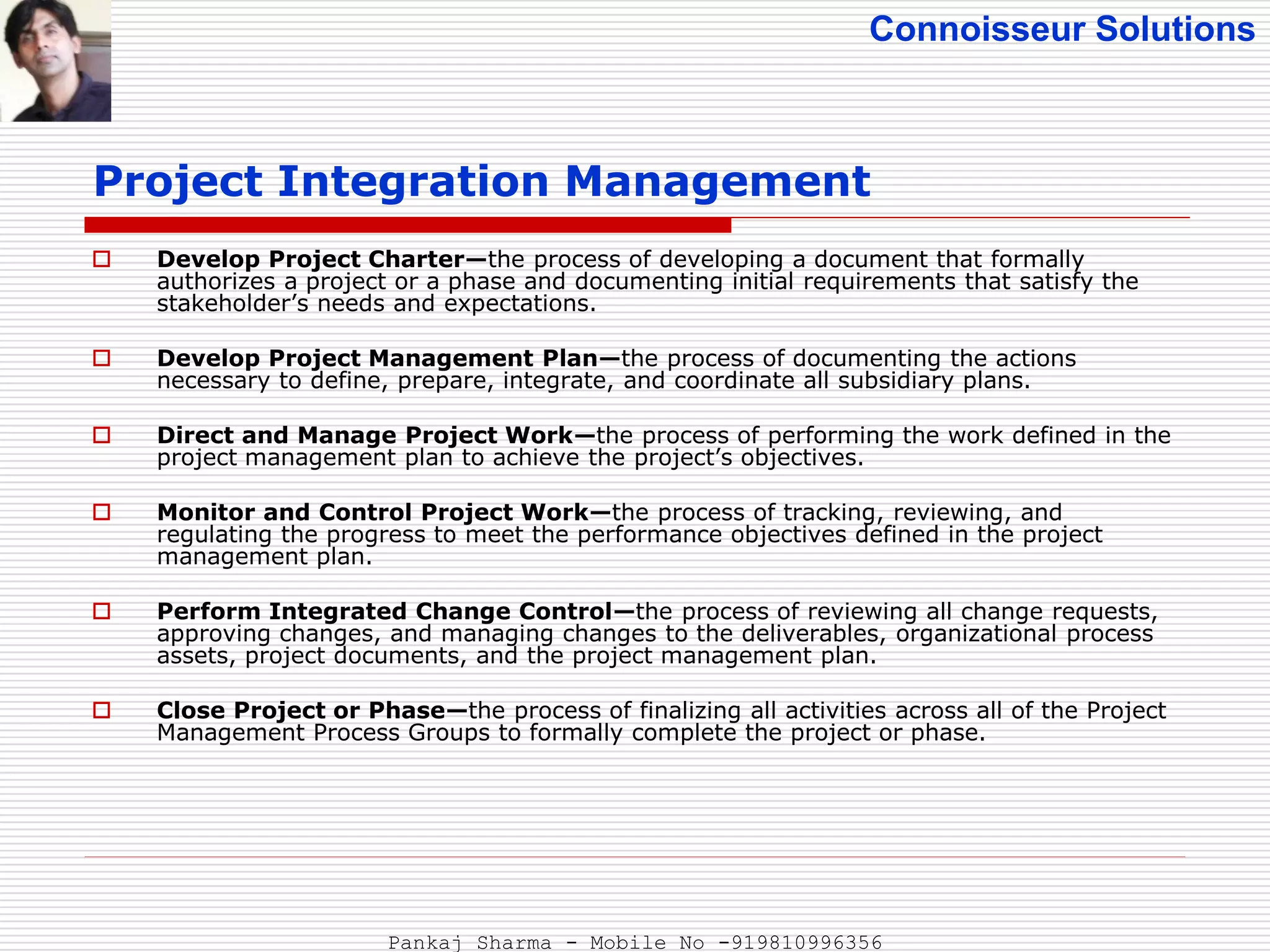

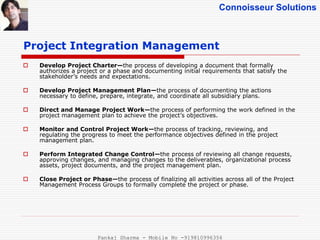

Processes and activities needed to identify, define, combine, unify,
and coordinate the various processes and project management
activities within the Project Management Process Groups
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
 Develop Project Charter—the process of developing a document that formally
authorizes a project or a phase and documenting initial requirements that satisfy the
stakeholder’s needs and expectations.
 Develop Project Management Plan—the process of documenting the actions
necessary to define, prepare, integrate, and coordinate all subsidiary plans.
 Direct and Manage Project Work—the process of performing the work defined in the
project management plan to achieve the project’s objectives.
 Monitor and Control Project Work—the process of tracking, reviewing, and
regulating the progress to meet the performance objectives defined in the project
management plan.
 Perform Integrated Change Control—the process of reviewing all change requests,
approving changes, and managing changes to the deliverables, organizational process
assets, project documents, and the project management plan.
 Close Project or Phase—the process of finalizing all activities across all of the Project
Management Process Groups to formally complete the project or phase.
Project Integration Management
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

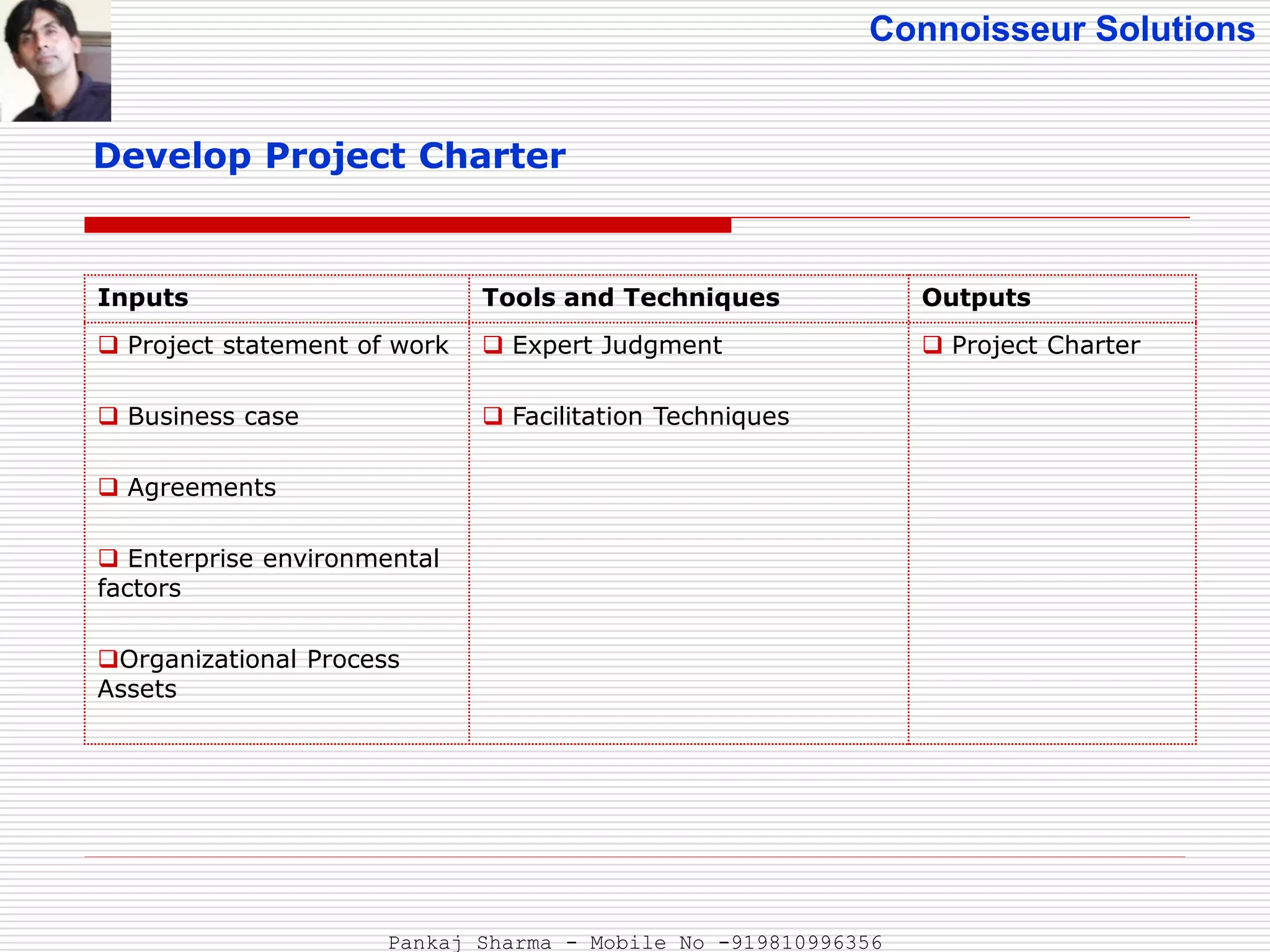

Develop Project Charter
Inputs Tools and Techniques Outputs
 Project statement of work
 Business case
 Agreements
 Enterprise environmental
factors
Organizational Process
Assets
 Expert Judgment
 Facilitation Techniques
 Project Charter
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

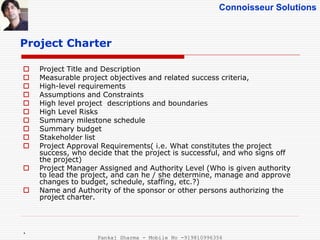

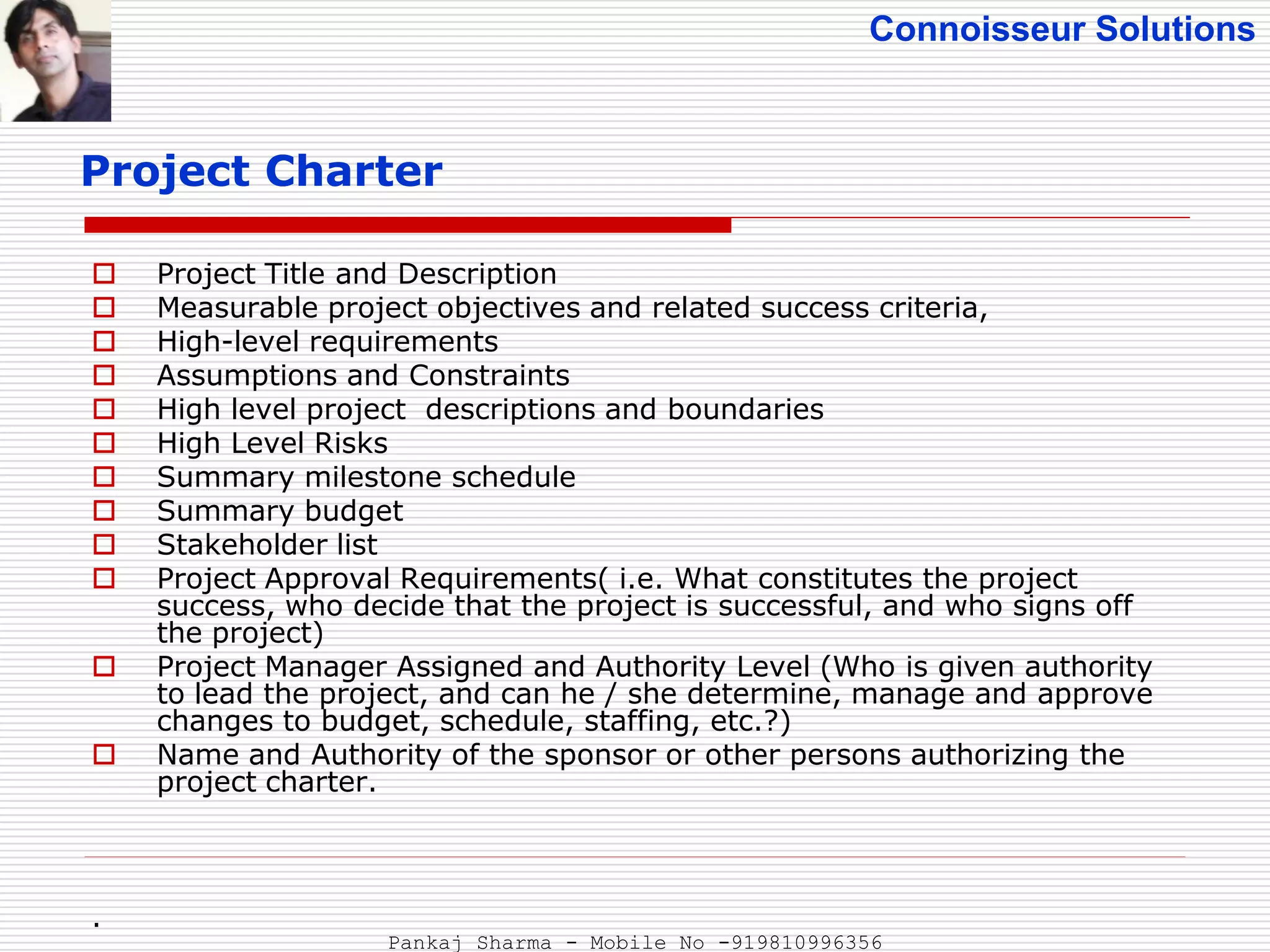

Project Charter
 Project Title and Description
 Measurable project objectives and related success criteria,
 High-level requirements
 Assumptions and Constraints
 High level project descriptions and boundaries
 High Level Risks
 Summary milestone schedule
 Summary budget
 Stakeholder list
 Project Approval Requirements( i.e. What constitutes the project
success, who decide that the project is successful, and who signs off
the project)
 Project Manager Assigned and Authority Level (Who is given authority
to lead the project, and can he / she determine, manage and approve
changes to budget, schedule, staffing, etc.?)
 Name and Authority of the sponsor or other persons authorizing the
project charter.
.
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

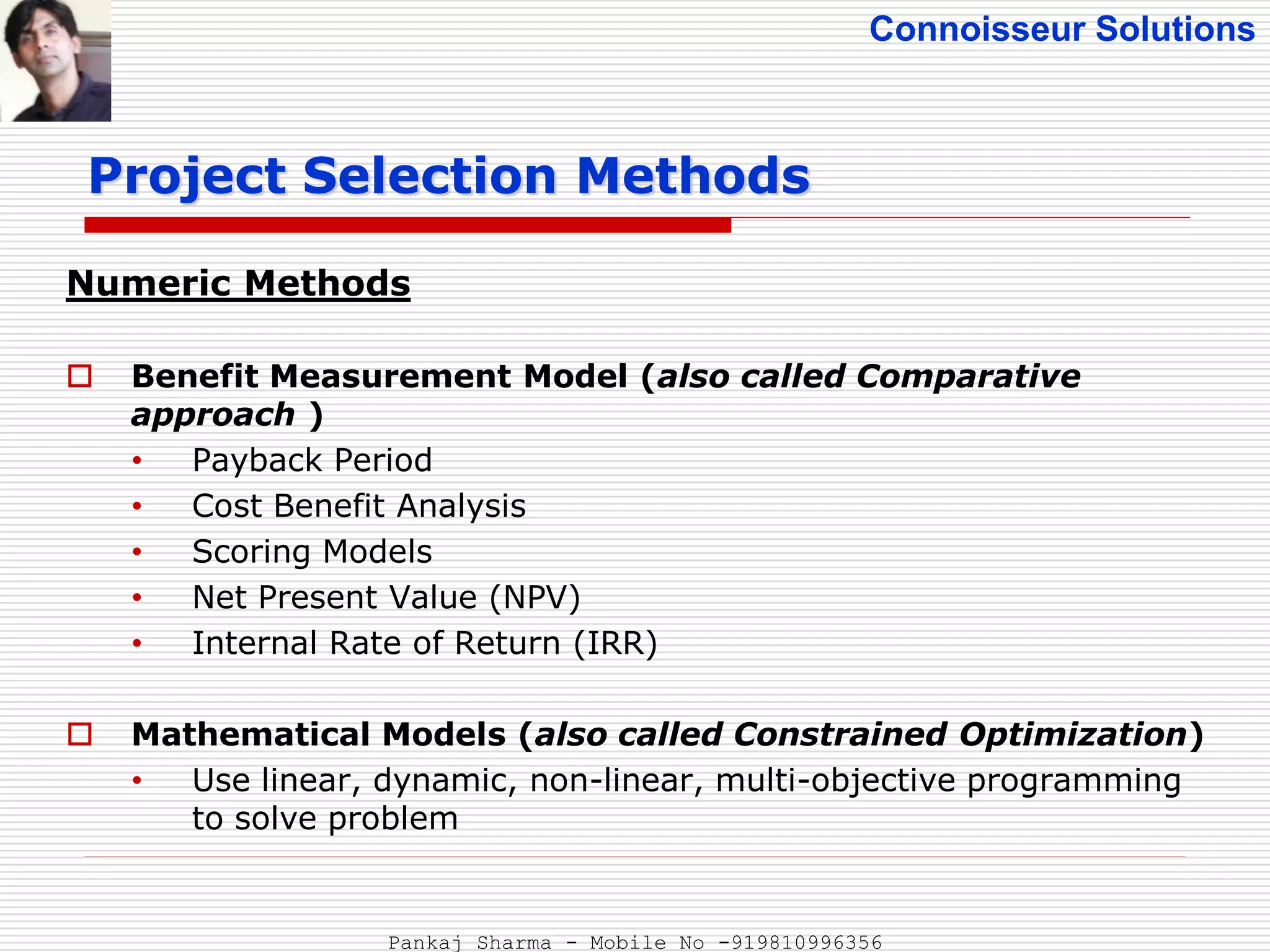

Numeric Methods
 Benefit Measurement Model (also called Comparative
approach )
• Payback Period
• Cost Benefit Analysis
• Scoring Models
• Net Present Value (NPV)
• Internal Rate of Return (IRR)
 Mathematical Models (also called Constrained Optimization)
• Use linear, dynamic, non-linear, multi-objective programming
to solve problem
Project Selection Methods
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Project Selection Methods

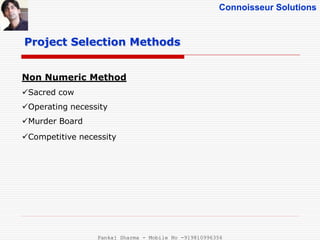

Non Numeric Method
Sacred cow
Operating necessity
Murder Board
Competitive necessity
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

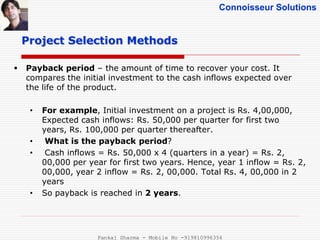

 Payback period – the amount of time to recover your cost. It
compares the initial investment to the cash inflows expected over
the life of the product.
• For example, Initial investment on a project is Rs. 4,00,000,
Expected cash inflows: Rs. 50,000 per quarter for first two
years, Rs. 100,000 per quarter thereafter.
• What is the payback period?
• Cash inflows = Rs. 50,000 x 4 (quarters in a year) = Rs. 2,
00,000 per year for first two years. Hence, year 1 inflow = Rs. 2,
00,000, year 2 inflow = Rs. 2, 00,000. Total Rs. 4, 00,000 in 2
years
• So payback is reached in 2 years.
Project Selection Methods
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
 Benefit Cost Ratio (BCR) or profitability Index . This is the ratio of project benefit
and the project cost.
• BCR = Revenue / Cost
• Select the project with a higher BCR
Project Selection Methods
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

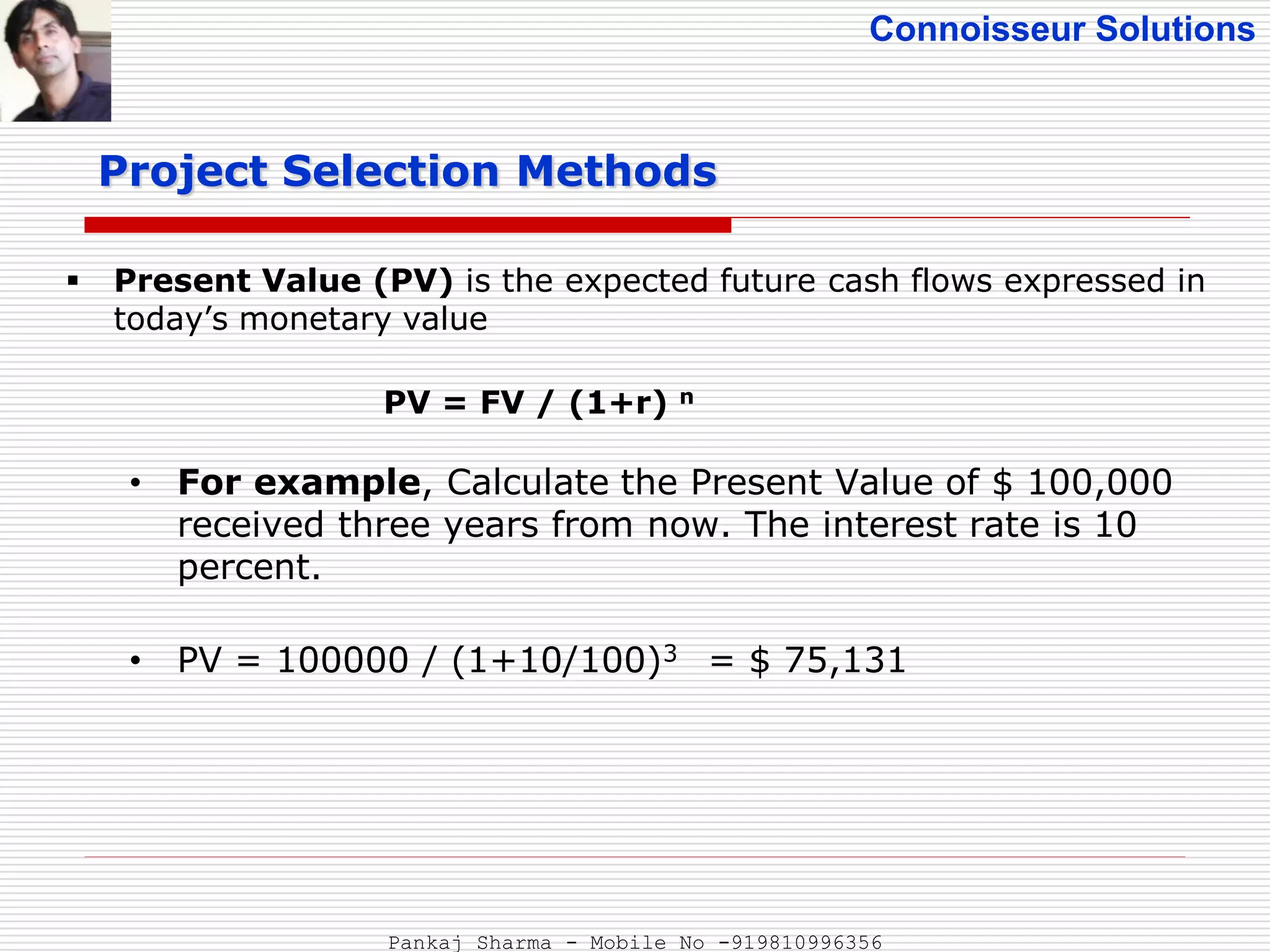

 Present Value (PV) is the expected future cash flows expressed in
today’s monetary value
PV = FV / (1+r) n
• For example, Calculate the Present Value of $ 100,000
received three years from now. The interest rate is 10
percent.
• PV = 100000 / (1+10/100)3 = $ 75,131
Project Selection Methods
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

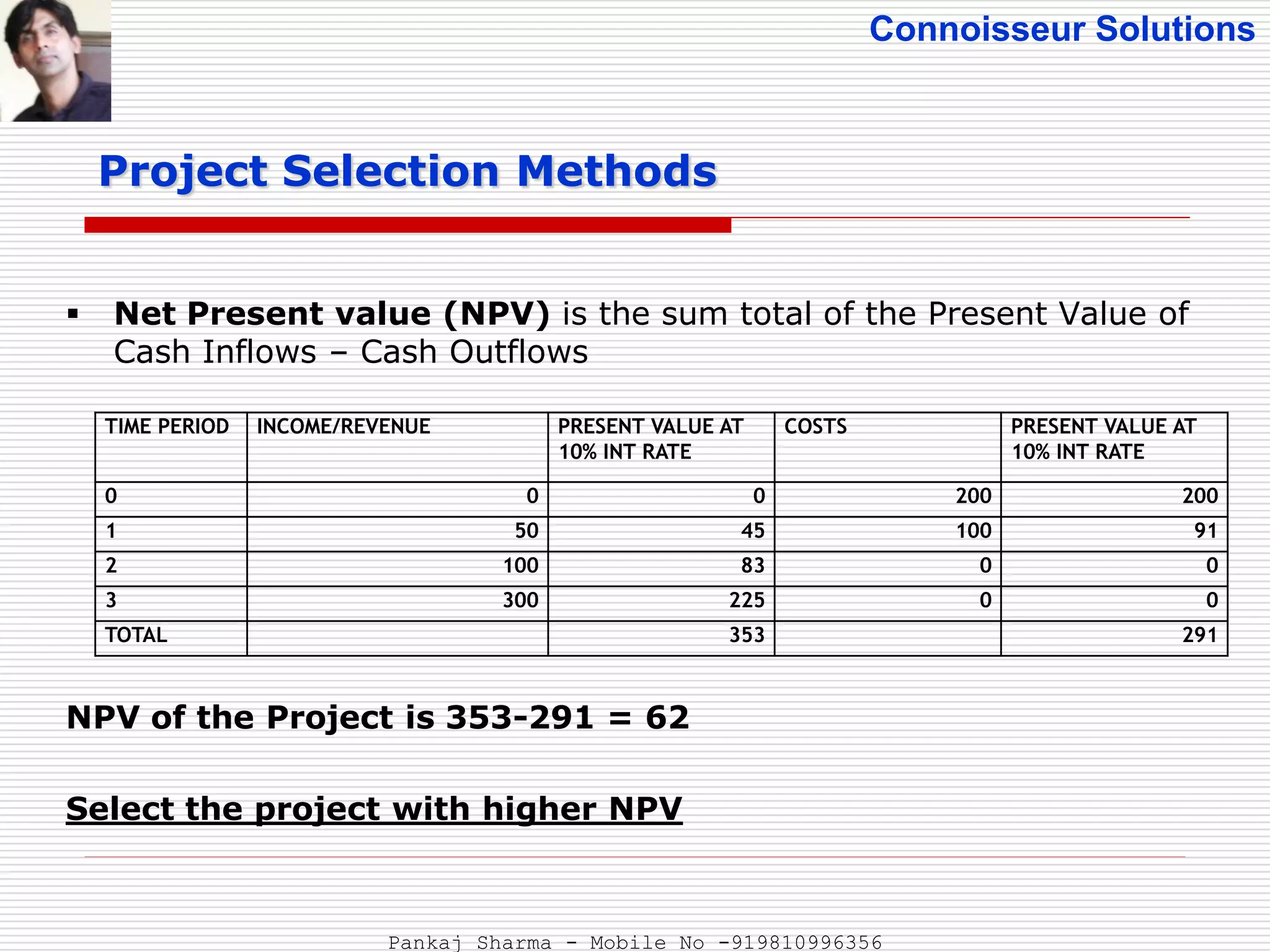

 Net Present value (NPV) is the sum total of the Present Value of
Cash Inflows – Cash Outflows
NPV of the Project is 353-291 = 62
Select the project with higher NPV
Project Selection Methods
TIME PERIOD INCOME/REVENUE PRESENT VALUE AT
10% INT RATE
COSTS PRESENT VALUE AT
10% INT RATE
0 0 0 200 200
1 50 45 100 91
2 100 83 0 0
3 300 225 0 0
TOTAL 353 291
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

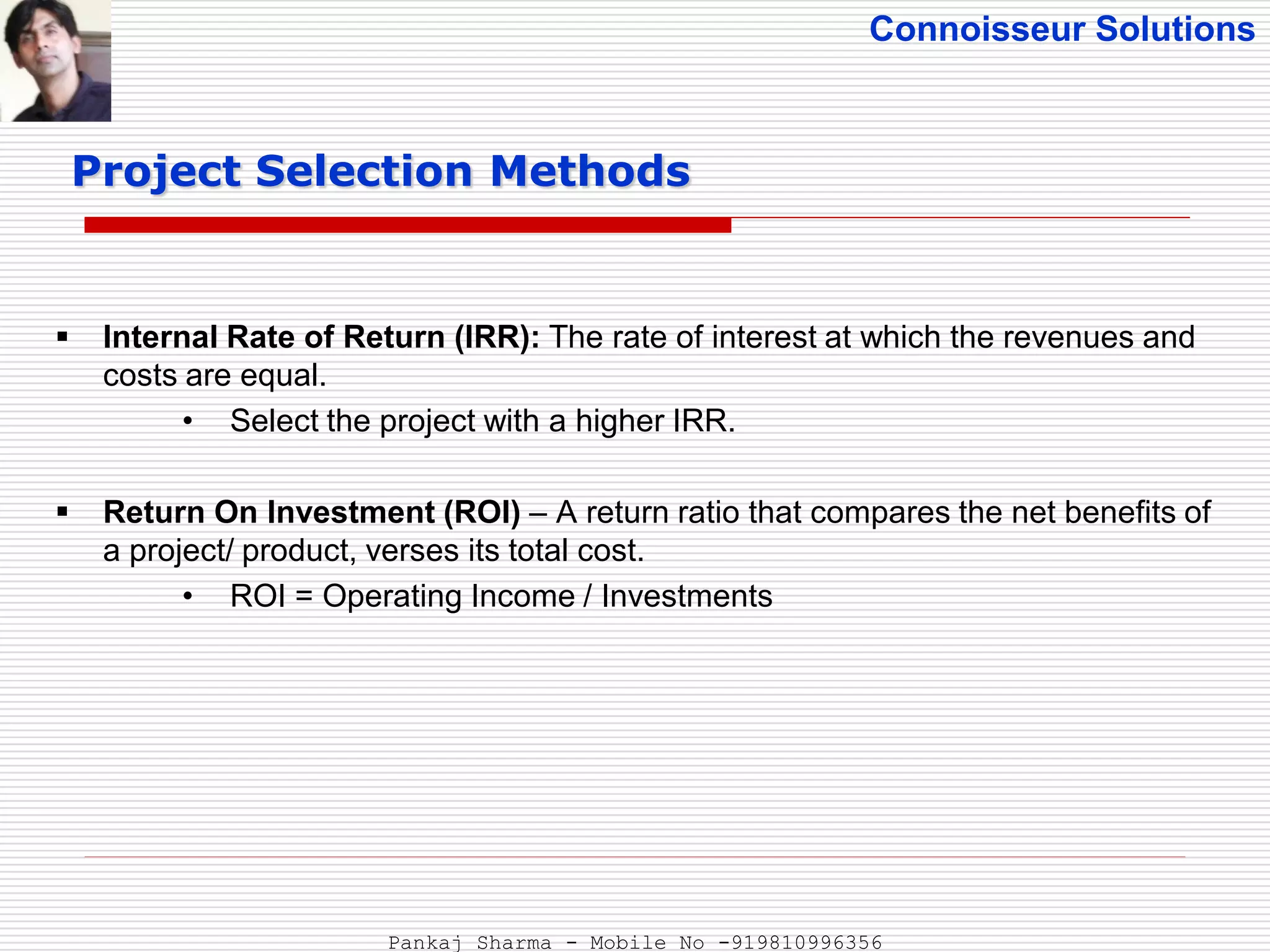

 Internal Rate of Return (IRR): The rate of interest at which the revenues and
costs are equal.
• Select the project with a higher IRR.
 Return On Investment (ROI) – A return ratio that compares the net benefits of
a project/ product, verses its total cost.
• ROI = Operating Income / Investments
Project Selection Methods
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

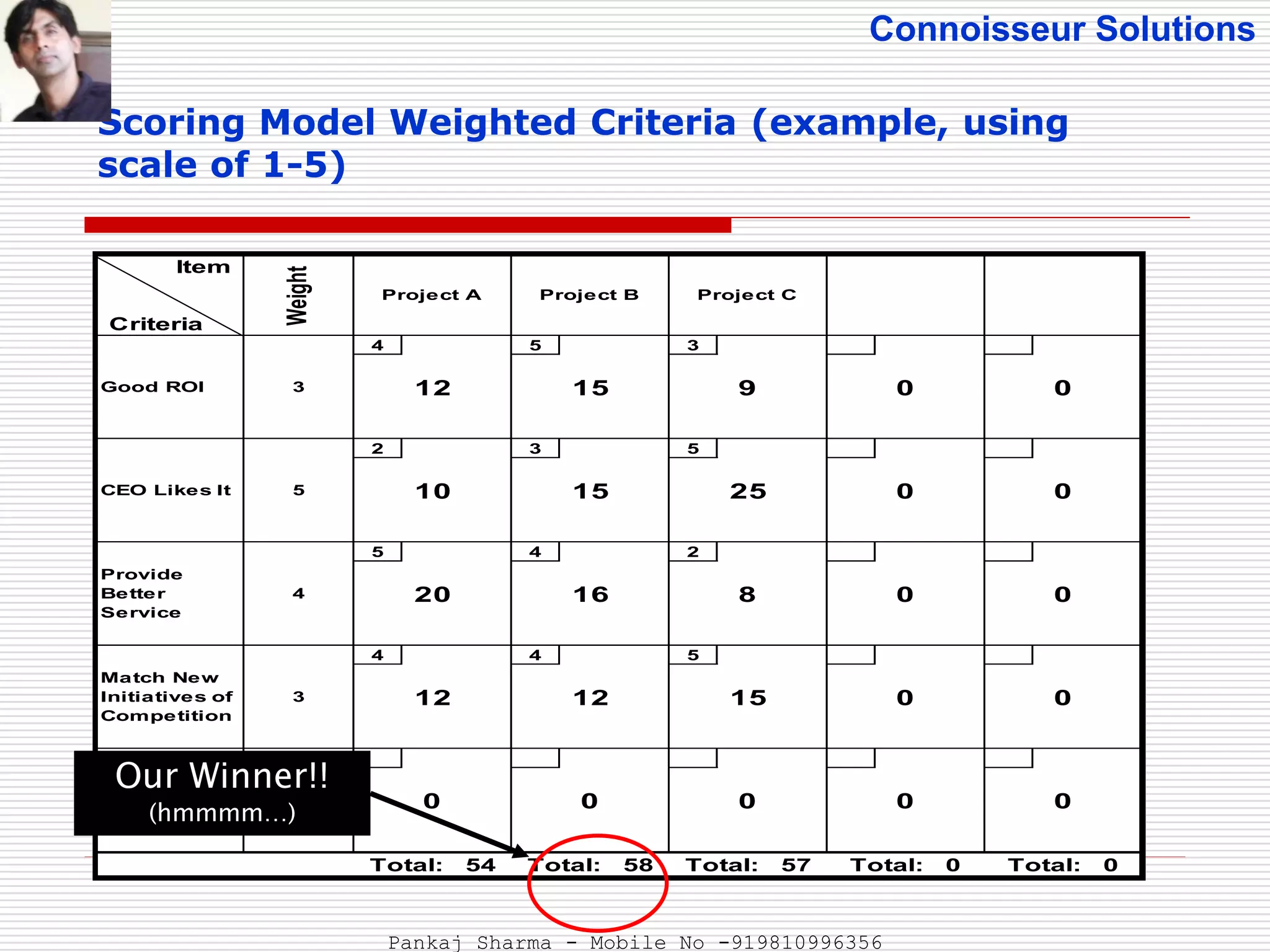

Scoring Model Weighted Criteria (example, using
scale of 1-5)
Item
Criteria
4 5 3
2 3 5
5 4 2
4 4 5
Good ROI 3 12 15 9 0 0
Weight Project A Project B Project C
CEO Likes It 5 10 15 25 0 0
Provide
Better
Service
4 20 16 8 0 0
Match New
Initiatives of
Competition
3 12 12 15 0 0
0 0 0 0 0
Total: 0Total: 54 Total: 58 Total: 57 Total: 0
Our Winner!!
(hmmmm…)
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

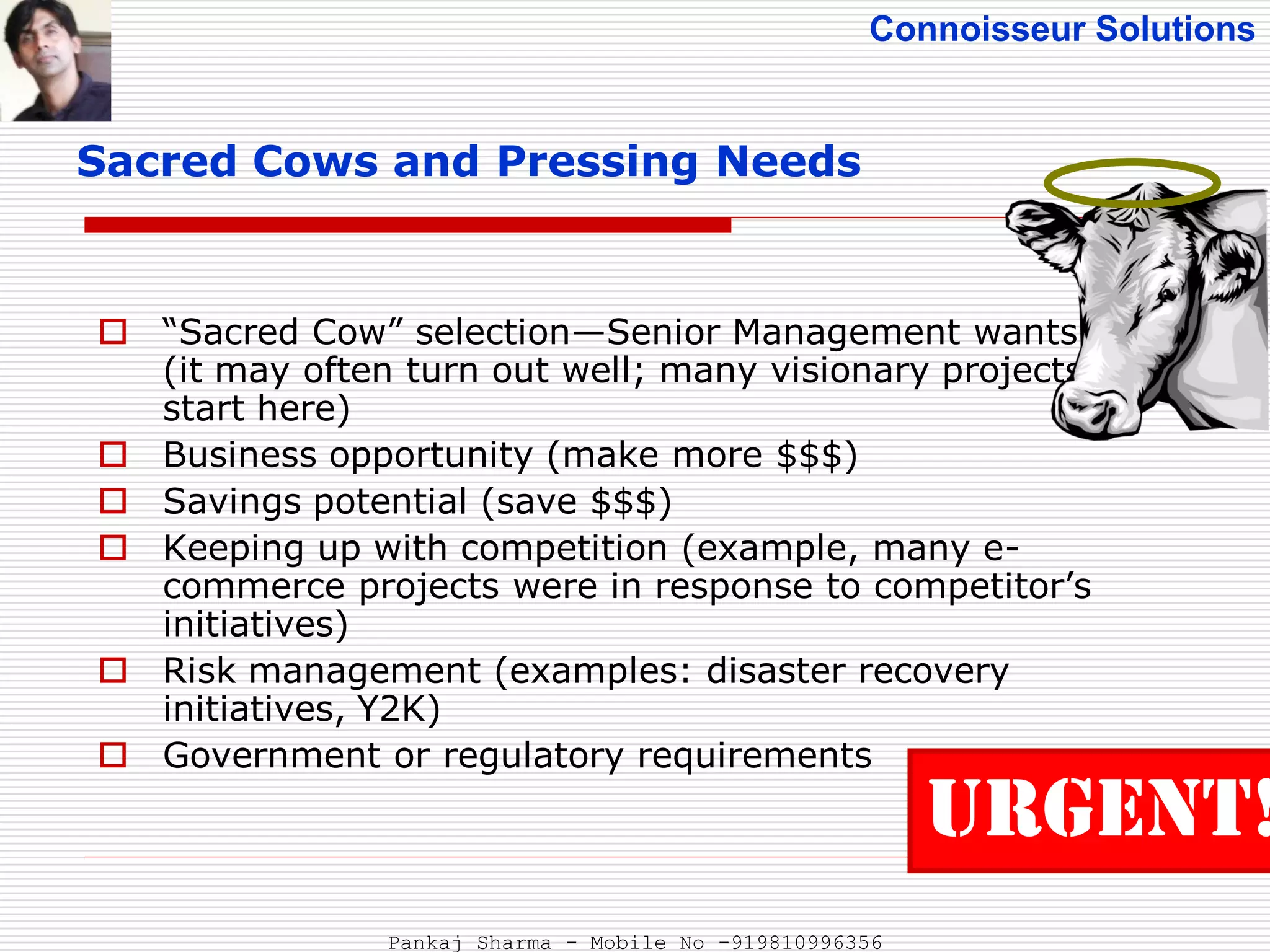

Sacred Cows and Pressing Needs
 “Sacred Cow” selection—Senior Management wants it!
(it may often turn out well; many visionary projects
start here)
 Business opportunity (make more $$$)
 Savings potential (save $$$)
 Keeping up with competition (example, many e-
commerce projects were in response to competitor’s
initiatives)
 Risk management (examples: disaster recovery
initiatives, Y2K)
 Government or regulatory requirements
URGENT!
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Murder Board
“Murder Board" is a term often used for the team created to see if
they can push hard on a project plan to see where it will break.
This process is called by other names as well, depending on the
subject of the scrutiny and type of firm in which it is employed. For
a hard review of a proposal, it is usually called a "red team." Some
consulting firms call final briefing reviews "gauntlet drills."
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

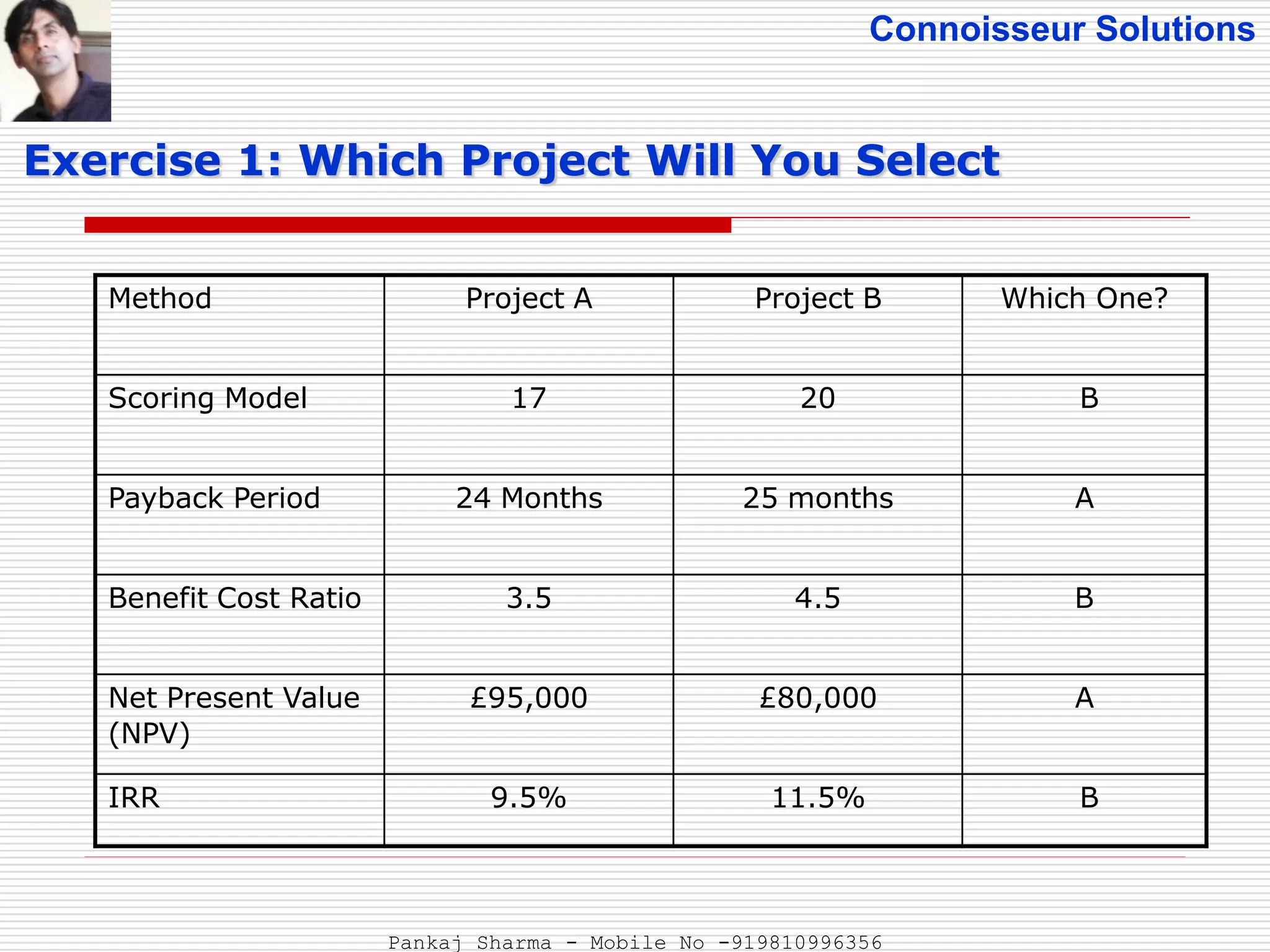

Method Project A Project B Which One?
Scoring Model 17 20 B
Payback Period 24 Months 25 months A
Benefit Cost Ratio 3.5 4.5 B
Net Present Value
(NPV)
£95,000 £80,000 A
IRR 9.5% 11.5% B
Exercise 1: Which Project Will You Select
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Project Management Plan
The project management plan defines how the
project is executed, monitored and controlled, and
closed. The project management plan content will
vary depending upon the application area and
complexity of the project.
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

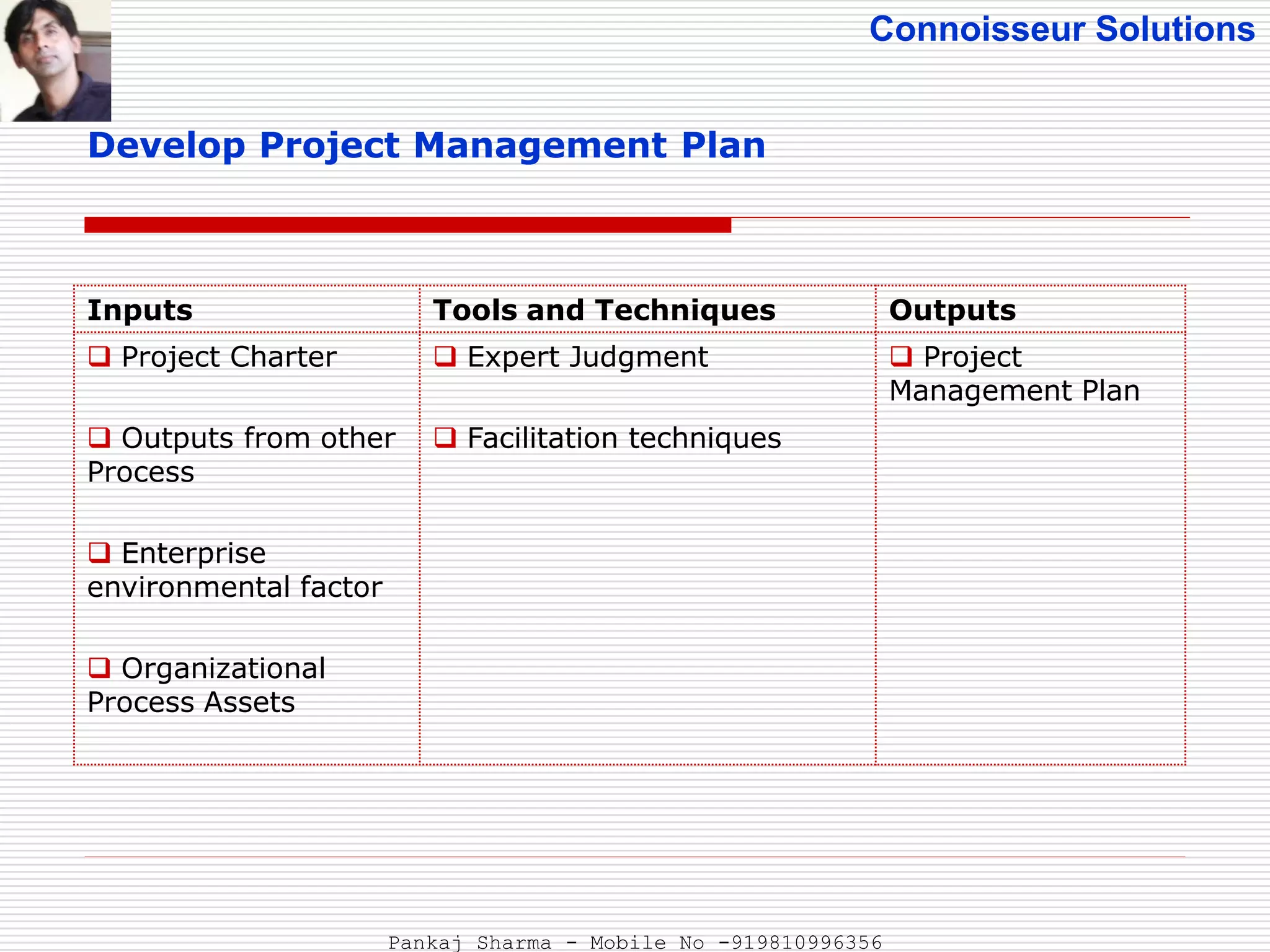

Develop Project Management Plan
Inputs Tools and Techniques Outputs
 Project Charter
 Outputs from other
Process
 Enterprise
environmental factor
 Organizational
Process Assets
 Expert Judgment
 Facilitation techniques
 Project
Management Plan
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

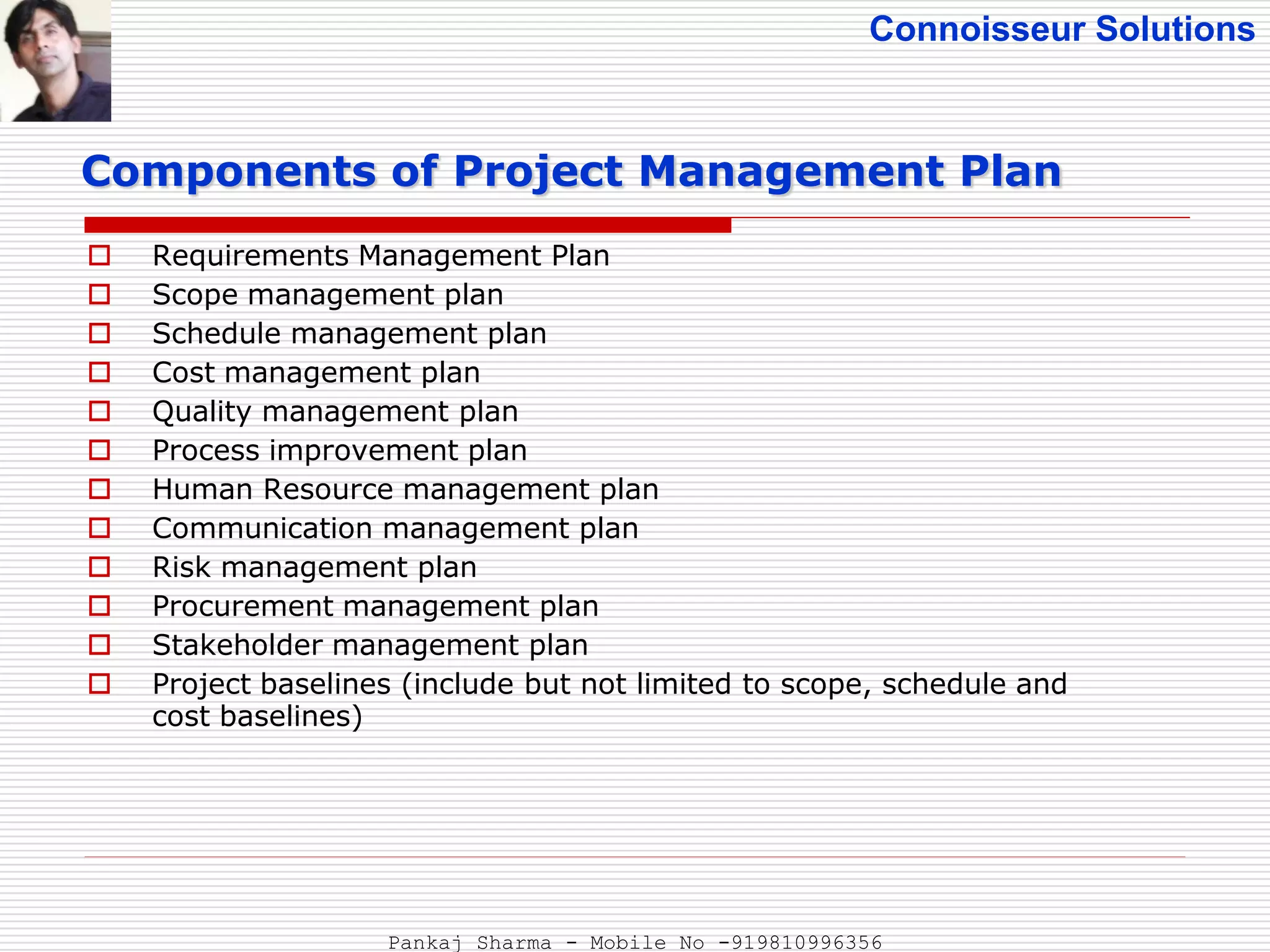

 Requirements Management Plan
 Scope management plan
 Schedule management plan
 Cost management plan
 Quality management plan
 Process improvement plan
 Human Resource management plan
 Communication management plan
 Risk management plan
 Procurement management plan
 Stakeholder management plan
 Project baselines (include but not limited to scope, schedule and
cost baselines)
Components of Project Management Plan
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

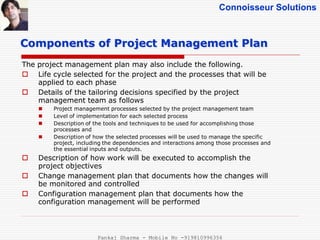

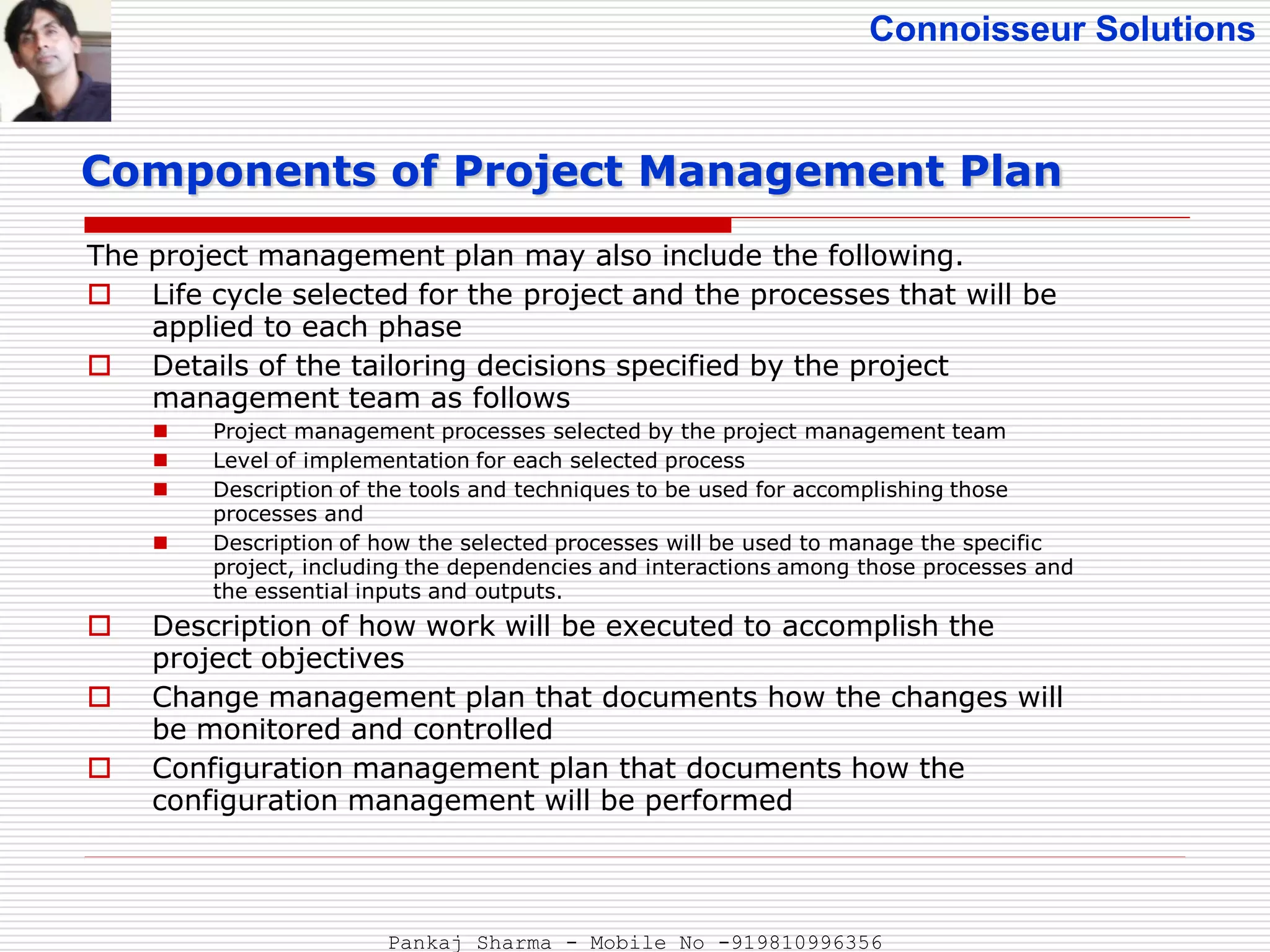

The project management plan may also include the following.
 Life cycle selected for the project and the processes that will be
applied to each phase
 Details of the tailoring decisions specified by the project
management team as follows
 Project management processes selected by the project management team
 Level of implementation for each selected process
 Description of the tools and techniques to be used for accomplishing those
processes and
 Description of how the selected processes will be used to manage the specific
project, including the dependencies and interactions among those processes and
the essential inputs and outputs.
 Description of how work will be executed to accomplish the
project objectives
 Change management plan that documents how the changes will
be monitored and controlled
 Configuration management plan that documents how the
configuration management will be performed
Components of Project Management Plan
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
 Description of how the integrity of the project baselines will be
maintained
 Requirements and techniques for communicating among
stakeholders
 Key management reviews for the content, the extent of, and
timing to address, open issues and pending decisions
Components of Project Management Plan
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Direct and Manage Project Work
Direct and Manage Project Work is the process of performing
the work defined in the project management plan and
implementing approved changes to achieve the project’s
objectives.
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Activities in Direct and Manage Project Work
The activities include, but are not limited to:
 Perform activities to accomplish project requirements;
 Create project deliverables
 Staff, train, and manage the team members assigned to the project
 Obtain, manage, and use resources including materials, tools,
equipment, and facilities
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Activities in Direct and Manage Project Work

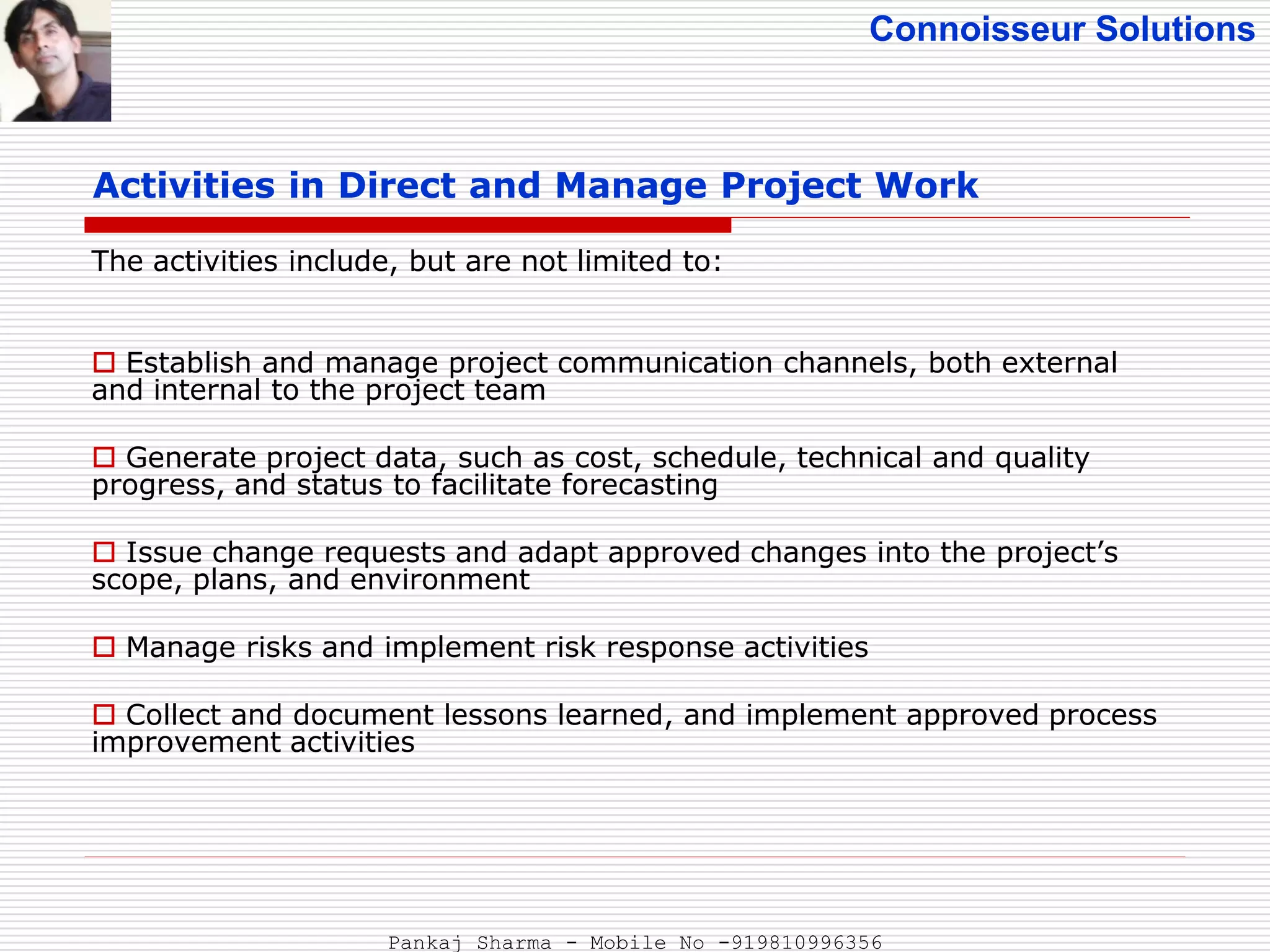

The activities include, but are not limited to:
 Establish and manage project communication channels, both external
and internal to the project team
 Generate project data, such as cost, schedule, technical and quality
progress, and status to facilitate forecasting
 Issue change requests and adapt approved changes into the project’s
scope, plans, and environment
 Manage risks and implement risk response activities
 Collect and document lessons learned, and implement approved process
improvement activities
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

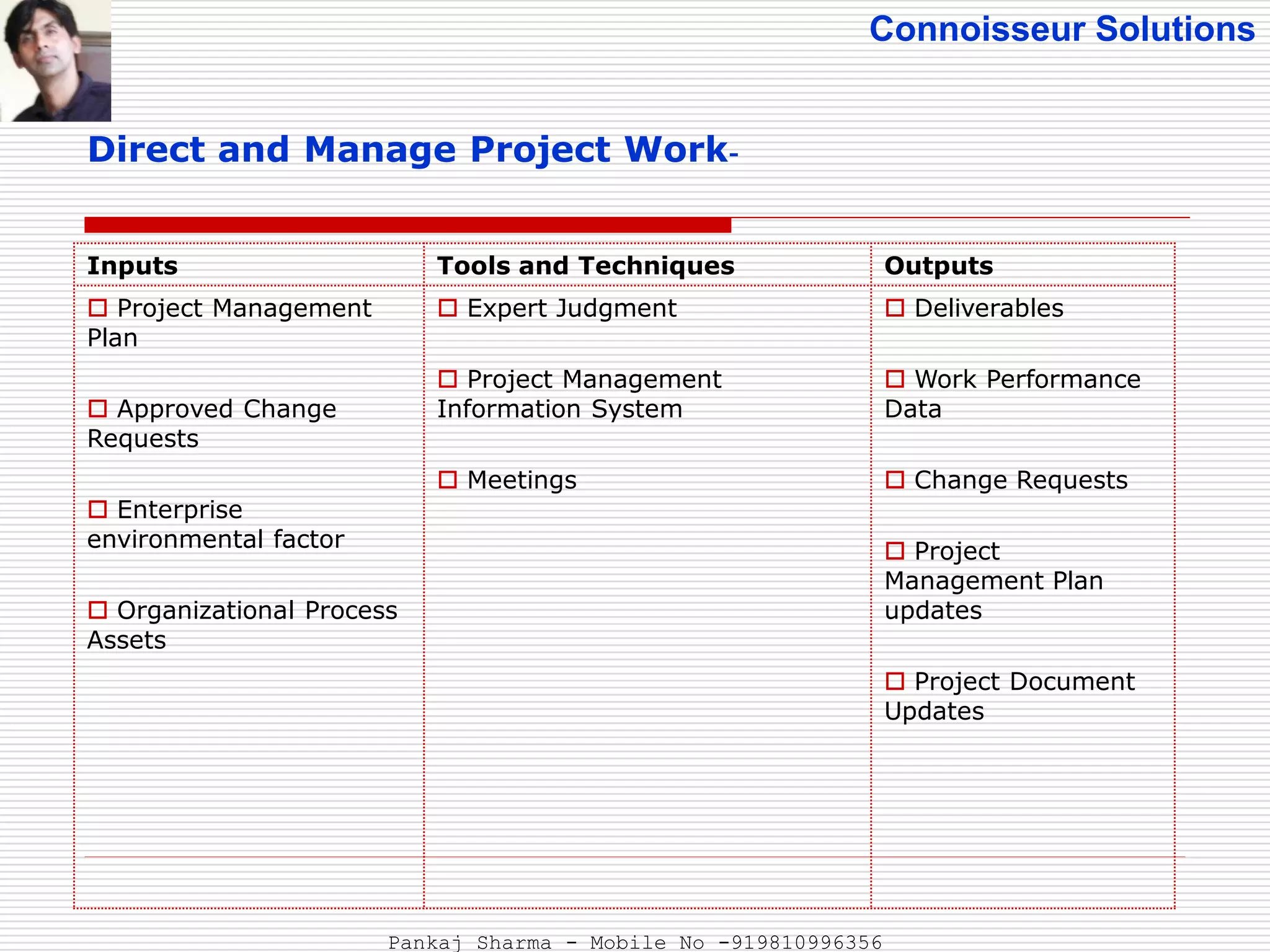

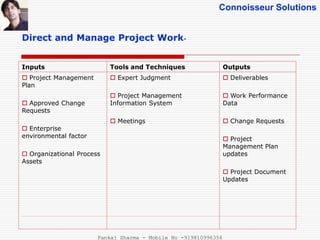

Direct and Manage Project Work-
Inputs Tools and Techniques Outputs
 Project Management
Plan
 Approved Change
Requests
 Enterprise
environmental factor
 Organizational Process
Assets
 Expert Judgment
 Project Management
Information System
 Meetings
 Deliverables
 Work Performance
Data
 Change Requests
 Project
Management Plan
updates
 Project Document
Updates
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Monitor and Control Project Work
Monitor and Control Project Work is the process of tracking,
reviewing, and regulating the progress to meet the
performance objectives defined in the project management
plan.
Continuous monitoring gives the project management team
insight into the health of the project, and identifies any
areas that may require special attention. Control includes
determining corrective or preventive actions or re-planning
and following up on action plans to determine if the actions
taken resolved the performance issue.
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

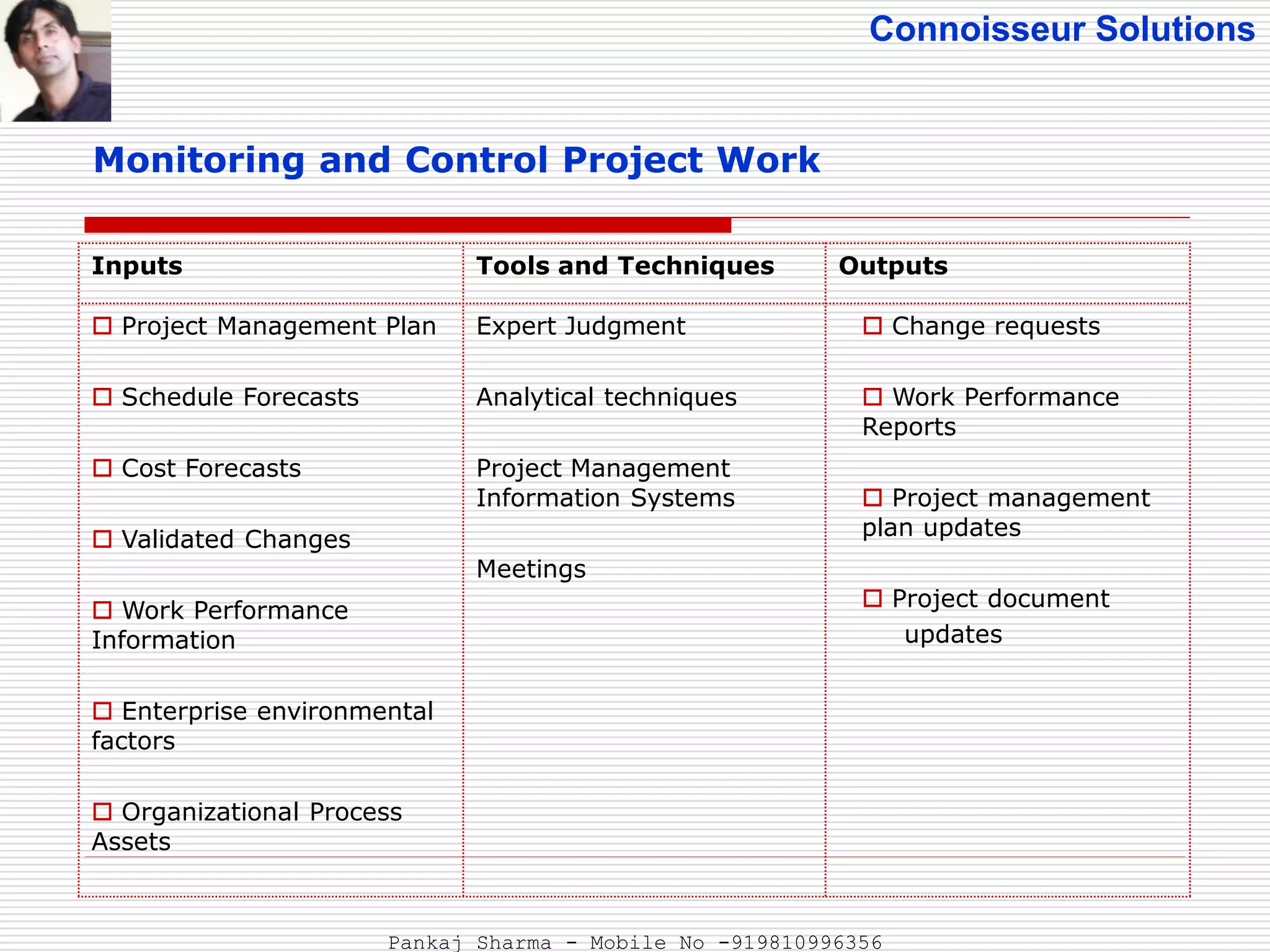

Monitoring and Control Project Work
Inputs Tools and Techniques Outputs
 Project Management Plan
 Schedule Forecasts
 Cost Forecasts
 Validated Changes
 Work Performance
Information
 Enterprise environmental
factors
 Organizational Process
Assets
Expert Judgment
Analytical techniques
Project Management
Information Systems
Meetings
 Change requests
 Work Performance
Reports
 Project management
plan updates
 Project document
updates
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Perform Integrated Change Control
Perform Integrated Change Control is the process of review
in all change requests, approving changes and managing
changes to the deliverables, organizational process assets,
project documents and the project management plan.
The Perform Integrated Change Control process is conducted
from project inception through completion. The project
management plan, the project scope statement, and other
deliverables are maintained by carefully and continuously
managing changes, either by rejecting changes or by
approving changes thereby assuring that only approved
changes are incorporated into a revised baseline.
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

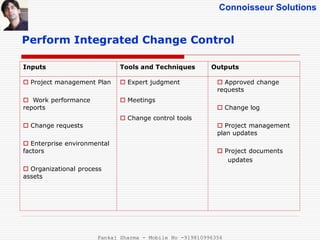

Perform Integrated Change Control
Inputs Tools and Techniques Outputs
 Project management Plan
 Work performance
reports
 Change requests
 Enterprise environmental
factors
 Organizational process
assets
 Expert judgment
 Meetings
 Change control tools
 Approved change
requests
 Change log
 Project management
plan updates
 Project documents
updates
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Close Project or Phase
Close Project or Phase is the process of finalizing all
activities across all of the Project Management Process
Groups to formally complete the project or phase.
When closing the project, the project manager will review
all prior information from the previous phase closures to
ensure that all project work is complete and that the
project has met its objectives.
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Close Project or Phase
Inputs Tools and Techniques Outputs
 Project Management Plan
 Accepted Deliverables
 Organizational Process
Assets
Expert Judgment
Analytical techniques
Meetings
Final product, service,
or result transition
Organizational process
assets updates
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions

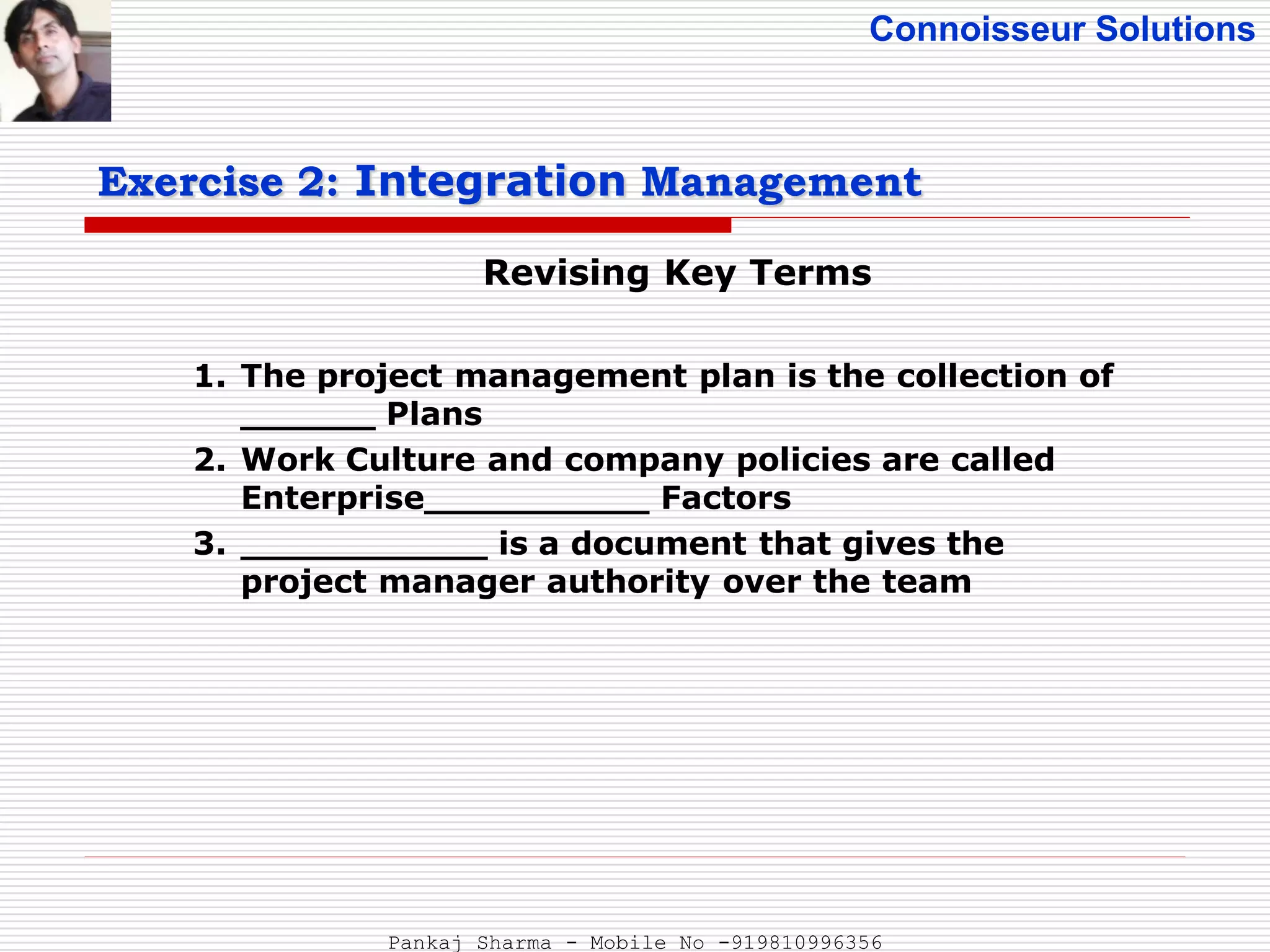

Revising Key Terms
Exercise 2: Integration Management
1. The project management plan is the collection of
______ Plans
2. Work Culture and company policies are called
Enterprise__________ Factors
3. ___________ is a document that gives the
project manager authority over the team
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
Revising Key Terms

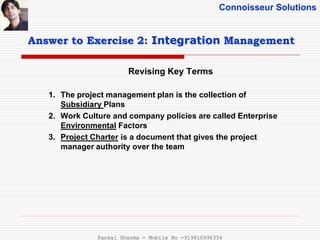

Answer to Exercise 2: Integration Management
1. The project management plan is the collection of
Subsidiary Plans
2. Work Culture and company policies are called Enterprise
Environmental Factors
3. Project Charter is a document that gives the project
manager authority over the team
Pankaj Sharma - Mobile No -919810996356
Connoisseur Solutions
QUIZ !
Pankaj Sharma - Mobile No -919810996356

Project Integration Management

  • 1.
    Connoisseur Solutions Project IntegrationManagement Pankaj Sharma - Mobile No -919810996356
  • 2.
    Connoisseur Solutions Project IntegrationManagement Processes and activities needed to identify, define, combine, unify, and coordinate the various processes and project management activities within the Project Management Process Groups Pankaj Sharma - Mobile No -919810996356
  • 3.
    Connoisseur Solutions  DevelopProject Charter—the process of developing a document that formally authorizes a project or a phase and documenting initial requirements that satisfy the stakeholder’s needs and expectations.  Develop Project Management Plan—the process of documenting the actions necessary to define, prepare, integrate, and coordinate all subsidiary plans.  Direct and Manage Project Work—the process of performing the work defined in the project management plan to achieve the project’s objectives.  Monitor and Control Project Work—the process of tracking, reviewing, and regulating the progress to meet the performance objectives defined in the project management plan.  Perform Integrated Change Control—the process of reviewing all change requests, approving changes, and managing changes to the deliverables, organizational process assets, project documents, and the project management plan.  Close Project or Phase—the process of finalizing all activities across all of the Project Management Process Groups to formally complete the project or phase. Project Integration Management Pankaj Sharma - Mobile No -919810996356
  • 4.
    Connoisseur Solutions Develop ProjectCharter Inputs Tools and Techniques Outputs  Project statement of work  Business case  Agreements  Enterprise environmental factors Organizational Process Assets  Expert Judgment  Facilitation Techniques  Project Charter Pankaj Sharma - Mobile No -919810996356
  • 5.
    Connoisseur Solutions Project Charter Project Title and Description  Measurable project objectives and related success criteria,  High-level requirements  Assumptions and Constraints  High level project descriptions and boundaries  High Level Risks  Summary milestone schedule  Summary budget  Stakeholder list  Project Approval Requirements( i.e. What constitutes the project success, who decide that the project is successful, and who signs off the project)  Project Manager Assigned and Authority Level (Who is given authority to lead the project, and can he / she determine, manage and approve changes to budget, schedule, staffing, etc.?)  Name and Authority of the sponsor or other persons authorizing the project charter. . Pankaj Sharma - Mobile No -919810996356
  • 6.
    Connoisseur Solutions Numeric Methods Benefit Measurement Model (also called Comparative approach ) • Payback Period • Cost Benefit Analysis • Scoring Models • Net Present Value (NPV) • Internal Rate of Return (IRR)  Mathematical Models (also called Constrained Optimization) • Use linear, dynamic, non-linear, multi-objective programming to solve problem Project Selection Methods Pankaj Sharma - Mobile No -919810996356
  • 7.
    Connoisseur Solutions Project SelectionMethods Non Numeric Method Sacred cow Operating necessity Murder Board Competitive necessity Pankaj Sharma - Mobile No -919810996356
  • 8.
    Connoisseur Solutions  Paybackperiod – the amount of time to recover your cost. It compares the initial investment to the cash inflows expected over the life of the product. • For example, Initial investment on a project is Rs. 4,00,000, Expected cash inflows: Rs. 50,000 per quarter for first two years, Rs. 100,000 per quarter thereafter. • What is the payback period? • Cash inflows = Rs. 50,000 x 4 (quarters in a year) = Rs. 2, 00,000 per year for first two years. Hence, year 1 inflow = Rs. 2, 00,000, year 2 inflow = Rs. 2, 00,000. Total Rs. 4, 00,000 in 2 years • So payback is reached in 2 years. Project Selection Methods Pankaj Sharma - Mobile No -919810996356
  • 9.
    Connoisseur Solutions  BenefitCost Ratio (BCR) or profitability Index . This is the ratio of project benefit and the project cost. • BCR = Revenue / Cost • Select the project with a higher BCR Project Selection Methods Pankaj Sharma - Mobile No -919810996356
  • 10.
    Connoisseur Solutions  PresentValue (PV) is the expected future cash flows expressed in today’s monetary value PV = FV / (1+r) n • For example, Calculate the Present Value of $ 100,000 received three years from now. The interest rate is 10 percent. • PV = 100000 / (1+10/100)3 = $ 75,131 Project Selection Methods Pankaj Sharma - Mobile No -919810996356
  • 11.
    Connoisseur Solutions  NetPresent value (NPV) is the sum total of the Present Value of Cash Inflows – Cash Outflows NPV of the Project is 353-291 = 62 Select the project with higher NPV Project Selection Methods TIME PERIOD INCOME/REVENUE PRESENT VALUE AT 10% INT RATE COSTS PRESENT VALUE AT 10% INT RATE 0 0 0 200 200 1 50 45 100 91 2 100 83 0 0 3 300 225 0 0 TOTAL 353 291 Pankaj Sharma - Mobile No -919810996356
  • 12.
    Connoisseur Solutions  InternalRate of Return (IRR): The rate of interest at which the revenues and costs are equal. • Select the project with a higher IRR.  Return On Investment (ROI) – A return ratio that compares the net benefits of a project/ product, verses its total cost. • ROI = Operating Income / Investments Project Selection Methods Pankaj Sharma - Mobile No -919810996356
  • 13.
    Connoisseur Solutions Scoring ModelWeighted Criteria (example, using scale of 1-5) Item Criteria 4 5 3 2 3 5 5 4 2 4 4 5 Good ROI 3 12 15 9 0 0 Weight Project A Project B Project C CEO Likes It 5 10 15 25 0 0 Provide Better Service 4 20 16 8 0 0 Match New Initiatives of Competition 3 12 12 15 0 0 0 0 0 0 0 Total: 0Total: 54 Total: 58 Total: 57 Total: 0 Our Winner!! (hmmmm…) Pankaj Sharma - Mobile No -919810996356
  • 14.
    Connoisseur Solutions Sacred Cowsand Pressing Needs  “Sacred Cow” selection—Senior Management wants it! (it may often turn out well; many visionary projects start here)  Business opportunity (make more $$$)  Savings potential (save $$$)  Keeping up with competition (example, many e- commerce projects were in response to competitor’s initiatives)  Risk management (examples: disaster recovery initiatives, Y2K)  Government or regulatory requirements URGENT! Pankaj Sharma - Mobile No -919810996356
  • 15.
    Connoisseur Solutions Murder Board “MurderBoard" is a term often used for the team created to see if they can push hard on a project plan to see where it will break. This process is called by other names as well, depending on the subject of the scrutiny and type of firm in which it is employed. For a hard review of a proposal, it is usually called a "red team." Some consulting firms call final briefing reviews "gauntlet drills." Pankaj Sharma - Mobile No -919810996356
  • 16.
    Connoisseur Solutions Method ProjectA Project B Which One? Scoring Model 17 20 B Payback Period 24 Months 25 months A Benefit Cost Ratio 3.5 4.5 B Net Present Value (NPV) £95,000 £80,000 A IRR 9.5% 11.5% B Exercise 1: Which Project Will You Select Pankaj Sharma - Mobile No -919810996356
  • 17.
    Connoisseur Solutions Project ManagementPlan The project management plan defines how the project is executed, monitored and controlled, and closed. The project management plan content will vary depending upon the application area and complexity of the project. Pankaj Sharma - Mobile No -919810996356
  • 18.
    Connoisseur Solutions Develop ProjectManagement Plan Inputs Tools and Techniques Outputs  Project Charter  Outputs from other Process  Enterprise environmental factor  Organizational Process Assets  Expert Judgment  Facilitation techniques  Project Management Plan Pankaj Sharma - Mobile No -919810996356
  • 19.
    Connoisseur Solutions  RequirementsManagement Plan  Scope management plan  Schedule management plan  Cost management plan  Quality management plan  Process improvement plan  Human Resource management plan  Communication management plan  Risk management plan  Procurement management plan  Stakeholder management plan  Project baselines (include but not limited to scope, schedule and cost baselines) Components of Project Management Plan Pankaj Sharma - Mobile No -919810996356
  • 20.
    Connoisseur Solutions The projectmanagement plan may also include the following.  Life cycle selected for the project and the processes that will be applied to each phase  Details of the tailoring decisions specified by the project management team as follows  Project management processes selected by the project management team  Level of implementation for each selected process  Description of the tools and techniques to be used for accomplishing those processes and  Description of how the selected processes will be used to manage the specific project, including the dependencies and interactions among those processes and the essential inputs and outputs.  Description of how work will be executed to accomplish the project objectives  Change management plan that documents how the changes will be monitored and controlled  Configuration management plan that documents how the configuration management will be performed Components of Project Management Plan Pankaj Sharma - Mobile No -919810996356
  • 21.
    Connoisseur Solutions  Descriptionof how the integrity of the project baselines will be maintained  Requirements and techniques for communicating among stakeholders  Key management reviews for the content, the extent of, and timing to address, open issues and pending decisions Components of Project Management Plan Pankaj Sharma - Mobile No -919810996356
  • 22.
    Connoisseur Solutions Direct andManage Project Work Direct and Manage Project Work is the process of performing the work defined in the project management plan and implementing approved changes to achieve the project’s objectives. Pankaj Sharma - Mobile No -919810996356
  • 23.
    Connoisseur Solutions Activities inDirect and Manage Project Work The activities include, but are not limited to:  Perform activities to accomplish project requirements;  Create project deliverables  Staff, train, and manage the team members assigned to the project  Obtain, manage, and use resources including materials, tools, equipment, and facilities Pankaj Sharma - Mobile No -919810996356
  • 24.
    Connoisseur Solutions Activities inDirect and Manage Project Work The activities include, but are not limited to:  Establish and manage project communication channels, both external and internal to the project team  Generate project data, such as cost, schedule, technical and quality progress, and status to facilitate forecasting  Issue change requests and adapt approved changes into the project’s scope, plans, and environment  Manage risks and implement risk response activities  Collect and document lessons learned, and implement approved process improvement activities Pankaj Sharma - Mobile No -919810996356
  • 25.
    Connoisseur Solutions Direct andManage Project Work- Inputs Tools and Techniques Outputs  Project Management Plan  Approved Change Requests  Enterprise environmental factor  Organizational Process Assets  Expert Judgment  Project Management Information System  Meetings  Deliverables  Work Performance Data  Change Requests  Project Management Plan updates  Project Document Updates Pankaj Sharma - Mobile No -919810996356
  • 26.
    Connoisseur Solutions Monitor andControl Project Work Monitor and Control Project Work is the process of tracking, reviewing, and regulating the progress to meet the performance objectives defined in the project management plan. Continuous monitoring gives the project management team insight into the health of the project, and identifies any areas that may require special attention. Control includes determining corrective or preventive actions or re-planning and following up on action plans to determine if the actions taken resolved the performance issue. Pankaj Sharma - Mobile No -919810996356
  • 27.
    Connoisseur Solutions Monitoring andControl Project Work Inputs Tools and Techniques Outputs  Project Management Plan  Schedule Forecasts  Cost Forecasts  Validated Changes  Work Performance Information  Enterprise environmental factors  Organizational Process Assets Expert Judgment Analytical techniques Project Management Information Systems Meetings  Change requests  Work Performance Reports  Project management plan updates  Project document updates Pankaj Sharma - Mobile No -919810996356
  • 28.
    Connoisseur Solutions Perform IntegratedChange Control Perform Integrated Change Control is the process of review in all change requests, approving changes and managing changes to the deliverables, organizational process assets, project documents and the project management plan. The Perform Integrated Change Control process is conducted from project inception through completion. The project management plan, the project scope statement, and other deliverables are maintained by carefully and continuously managing changes, either by rejecting changes or by approving changes thereby assuring that only approved changes are incorporated into a revised baseline. Pankaj Sharma - Mobile No -919810996356
  • 29.
    Connoisseur Solutions Perform IntegratedChange Control Inputs Tools and Techniques Outputs  Project management Plan  Work performance reports  Change requests  Enterprise environmental factors  Organizational process assets  Expert judgment  Meetings  Change control tools  Approved change requests  Change log  Project management plan updates  Project documents updates Pankaj Sharma - Mobile No -919810996356
  • 30.
    Connoisseur Solutions Close Projector Phase Close Project or Phase is the process of finalizing all activities across all of the Project Management Process Groups to formally complete the project or phase. When closing the project, the project manager will review all prior information from the previous phase closures to ensure that all project work is complete and that the project has met its objectives. Pankaj Sharma - Mobile No -919810996356
  • 31.
    Connoisseur Solutions Close Projector Phase Inputs Tools and Techniques Outputs  Project Management Plan  Accepted Deliverables  Organizational Process Assets Expert Judgment Analytical techniques Meetings Final product, service, or result transition Organizational process assets updates Pankaj Sharma - Mobile No -919810996356
  • 32.
    Connoisseur Solutions Revising KeyTerms Exercise 2: Integration Management 1. The project management plan is the collection of ______ Plans 2. Work Culture and company policies are called Enterprise__________ Factors 3. ___________ is a document that gives the project manager authority over the team Pankaj Sharma - Mobile No -919810996356
  • 33.
    Connoisseur Solutions Revising KeyTerms Answer to Exercise 2: Integration Management 1. The project management plan is the collection of Subsidiary Plans 2. Work Culture and company policies are called Enterprise Environmental Factors 3. Project Charter is a document that gives the project manager authority over the team Pankaj Sharma - Mobile No -919810996356
  • 34.
    Connoisseur Solutions QUIZ ! PankajSharma - Mobile No -919810996356
