Embed presentation
Download to read offline

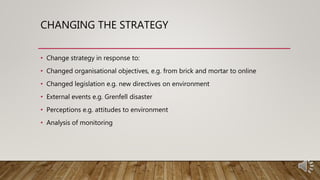

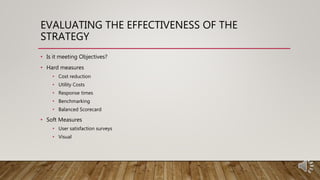

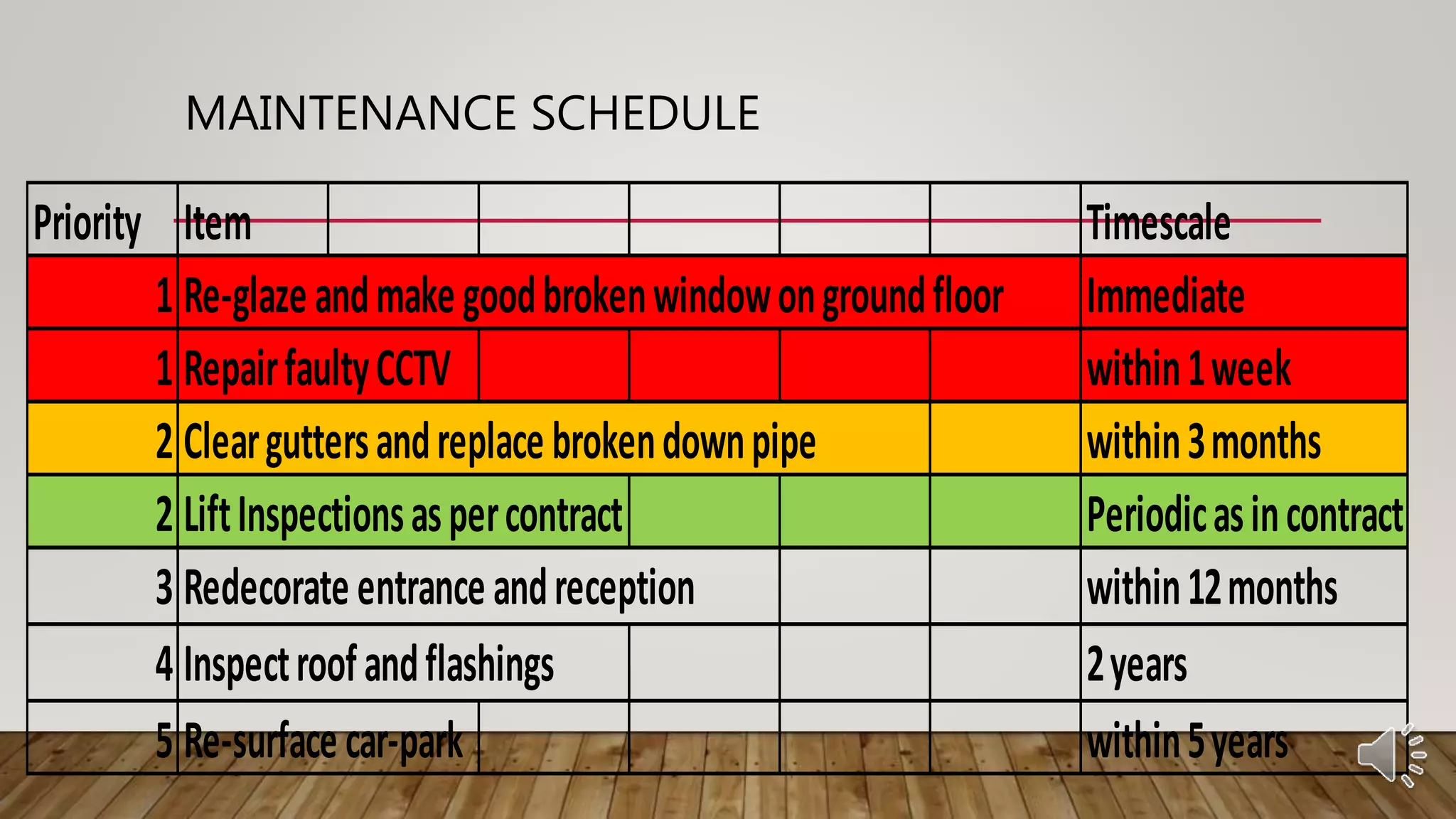

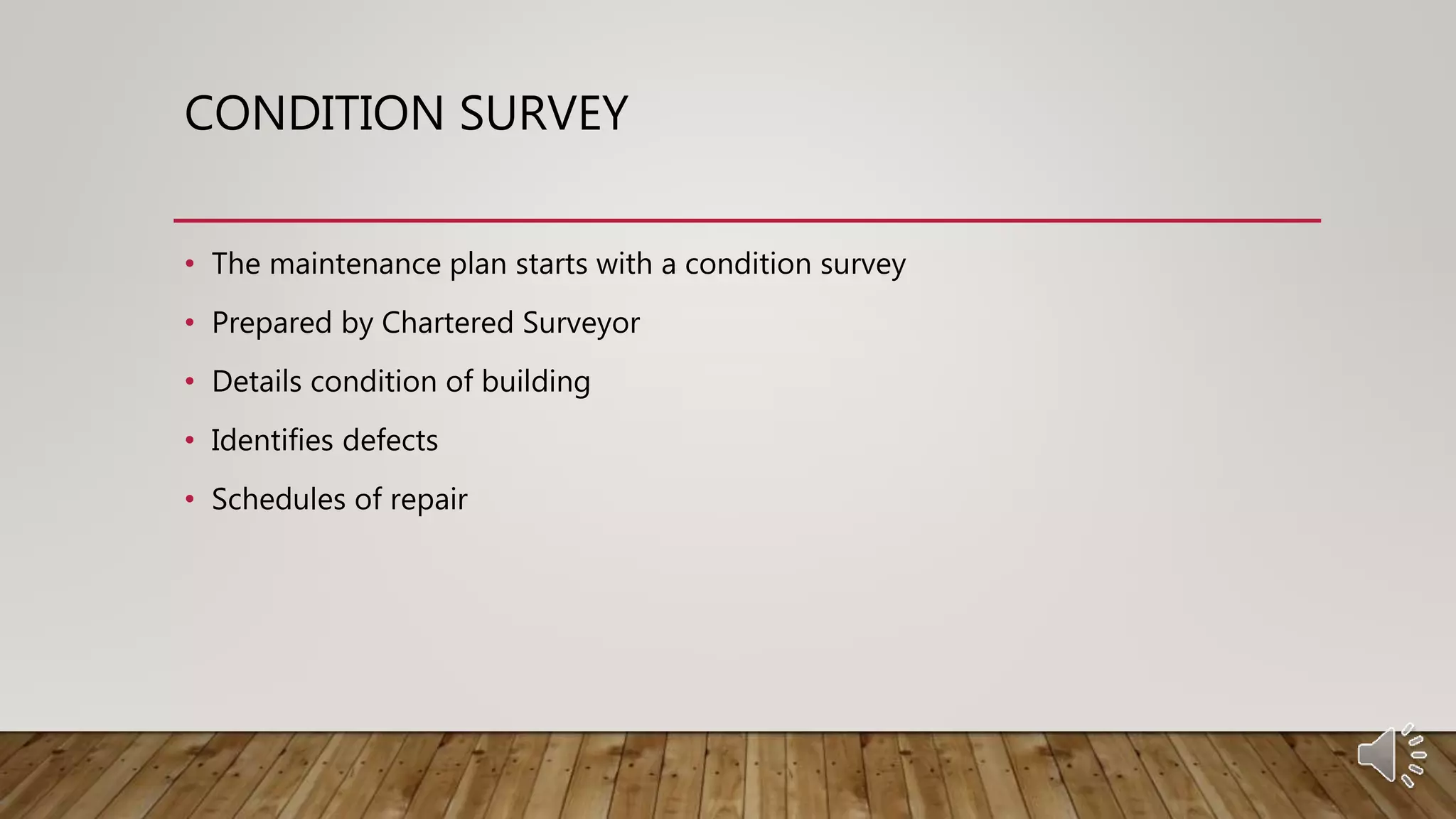

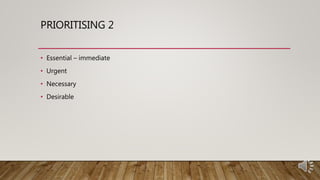

A maintenance plan begins with a condition survey conducted by a chartered surveyor to identify defects and schedule repairs. Repairs are prioritized based on risk, compliance, legislation, warranties, and functional or structural issues. A maintenance schedule then outlines the priority, item, and timescale for each repair from immediate to over 3 years. Progress is monitored through inspections, spreadsheets, and user feedback to evaluate if objectives are being met. The strategy can then be changed in response to organizational, legal, external event, or monitoring analysis factors.
