Lead Time:
What We Know About It
And How It Can Help Forecast Your Projects
Alexei Zheglov
Lean Kanban Asia-Pacific
Bangalore, December 2014
Alexei Zheglov
connected-
knowledge.com
alex@LeanAtoZ.com
@az1
#lkapac
“When a measure becomes a target,
it ceases to be a good measure.”
Goodhart’s Law

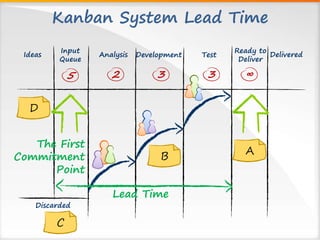

Kanban System Lead Time
DeliveredIdeas Analysis
Input
Queue
Ready to
Deliver
∞325
Development Test
3
Lead Time
The First
Commitment
Point
A
B
C
Discarded
D
Ask Not
DeliveredIdeas Analysis
Input
Queue
Ready to
Deliver
∞325
Development Test
3
Lead Time
A
B
C
Discarded
D
Not “how long will it take?”

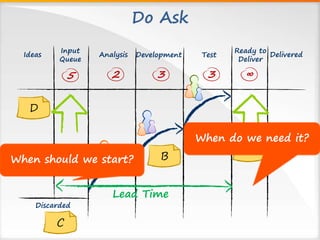

Do Ask
DeliveredIdeas Analysis
Input
Queue
Ready to
Deliver
∞325
Development Test
3
Lead Time
A
B
C
Discarded
D
When should we start?
When do we need it?
Decide
DeliveredIdeas Analysis
Input
Queue
Ready to
Deliver
∞325
Development Test
3
Lead Time
A
B
C
Discarded
D
One event
precedes (leads) another one
by this much
One event
precedes (leads) another one
by this much
Why?
DeliveredIdeas Analysis
Input
Queue
Ready to
Deliver
∞325
Development Test
3
Lead Time
The First
Commitment
Point
A
B
C
Discarded
D
Includes the time the
work item spent as
an option
Depends on the
transaction costs
(external to the
system)
Measures the
true delivery
capability
Customer Lead Time
DeliveredIdeas Activity 1
Input
Queue
Output
Buffer
∞???
Activity 2 Activity 3
?
Customer Lead Time
A
B
Kanban system(s) lead time
+
time spent in the unlimited
buffer(s)
C
Discarded
D
(Local) Cycle Time
DeliveredIdeas Activity 1
Input
Queue
Output
Buffer
∞???
Activity 2 Activity 3
?
A
B
C
Discarded
D
Cycle time is always local
Always qualify where
it is from and to
Often depends mainly on
the size of the local effort
Discussion 1: Gaming Metrics
• Given the goal to reduce the lead time (as we
have just defined it), what would you do?
• What would happen, good and bad?
• How can you game the local cycle time metric?
• Bonus question: if your delivery time metric
included the time before commitment, what
would you be motivated to do?
Ready
to Test

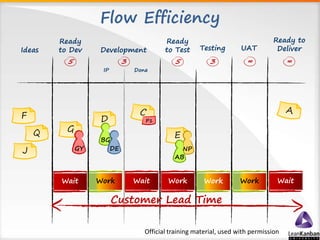

Flow Efficiency
F
E
J
G
D
GY
BG
DE NP
P1
AB
Customer Lead Time
Wait Wait WorkWork
Ideas
Ready
to Dev
5
IP
Development Testing
Done
3 35
UAT
Ready to
Deliver
∞ ∞
Work WaitWork
Official training material, used with permission
Ready
to Test
Flow Efficiency
F
E
J
G
D
GY
BG
DE NP
P1
AB
Customer Lead Time
Wait Wait WorkWork
Ideas
Ready
to Dev
5
IP
Development Testing
Done
3 35
UAT
Ready to
Deliver
∞ ∞
Work WaitWork
Official training material, used with permission
Work is waiting
Work is still waiting!
Multitasking creates
hidden queues!
Ready
to Test
Flow Efficiency
F
E
J
G
D
GY
BG
DE NP
P1
AB
Customer Lead Time
Wait Wait WorkWork
Ideas
Ready
to Dev
5
IP
Development Testing
Done
3 35
UAT
Ready to
Deliver
∞ ∞
Work WaitWork
Official training material, used with permission
%100
timeelapsed
timetouch
efficiencyflow 
Ready
to Test

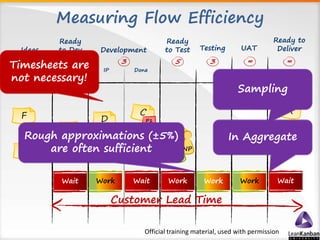

Measuring Flow Efficiency
F
E
J
G
D
GY
BG
DE NP
P1
AB
Customer Lead Time
Wait Wait WorkWork
Ideas
Ready
to Dev
5
IP
Development Testing
Done
3 35
UAT
Ready to
Deliver
∞ ∞
Work WaitWork
Official training material, used with permission
Timesheets are
not necessary!
Rough approximations (±5%)
are often sufficient
In Aggregate
Sampling
Ready
to Test
Measuring Flow Efficiency
F
E
J
G
D
GY
BG
DE NP
P1
AB
Customer Lead Time
Wait Wait WorkWork
Ideas
Ready
to Dev
5
IP
Development Testing
Done
3 35
UAT
Ready to
Deliver
∞ ∞
Work WaitWork
The results are often
between 1% and 5%*
*-Zsolt Fabok, Lean Agile Scotland 2012, LKFR12; Hakan Forss, LKFR13
The result is not limited to the number!
What did you decide to do?
If the Flow Efficiency Is 5%...
If... Before After Improvement
Hire 10x engineers 100 95.5 +4.7%
The task is three
times bigger 100 110 -9.1%
The task is three
times smaller 100 96.7 +3.4%
Reduce delays by
half 100 52.5 +90%
Discussion 2:
Consequences of Low Flow Efficiency
(all positives, really)
• Why is lead time is hard to fudge?
• Why does lead time improve mostly due to
system-level improvements?
• How likely are the lead time data from your
previous projects to help you plan a new one?
Measuring the delivery time
cannot be separated from
understanding commitment.
Goodhart’s Law’s
Corollary

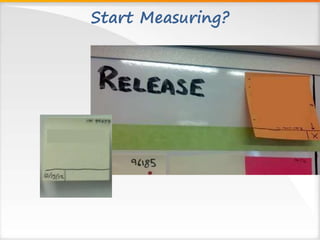

Start Measuring?
Discussion 3: Measuring Lead Time
• Do you already collect lead time data?
• If not, do you already have these data available
somewhere, waiting for you to discover them?
• If not, would it be difficult or easy to start?
• What would you do differently in your company
with respect to lead time data after this
presentation?
Deterministic approach
to a probabilistic process?
probabilistic
!!!
0
2
4
6
8
10
12
14
16
18
20
0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104

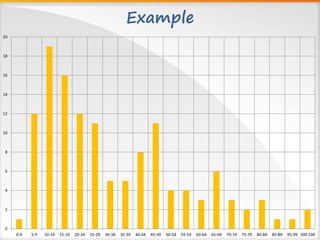

Example
0
2
4
6
8
10
12
14
16
18
20
0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104
Example
Best-fit distribution:
Weibull with
shape parameter k=1.62
Heterogeneous Demand
DeliveredIdeas Analysis
Input
Queue
Ready to
Deliver
∞325
Development Test
3
A
B
C
Discarded
D
E
G
F
H
Demand placed upon our system
is differentiated
by type of work and risk
Drill down by project type
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
2
4
6
8
10
12
14
16
18
20
Mixed data from
different types of
projects
4 types, 4 different distributions
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
2
4
6
8
10
12
14
16
18
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
75-79
80-84
85-89
100-104
0
1
2
3
4
5
6
0-4
5-9
10-14
15-19
20-24
25-29
40-44
55-59
60-64
65-69
70-74
75-79
95-99
...
...

Delivery Expectations
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
Shape Average In 98%
1.62
1.23
1.65
3.22
In 85% of cases
30 d
35 d
40 d
56 d
<51
<63
<68
<78
<83
<112*
<110*
<99
Delivery Expectations
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
Shape Average In 98%
1.62
1.23
1.65
3.22
In 85% of cases
30 d
35 d
40 d
56 d
<51
<63
<68
<78
<83
<112*
<110*
<99

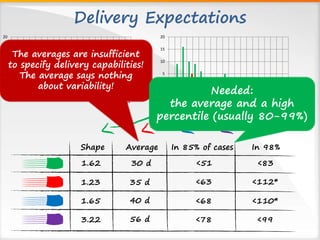

The averages are insufficient
to specify delivery capabilities!
The average says nothing
about variability!
Needed:
the average and a high
percentile (usually 80-99%)
Another Example
0
2
4
6
8
10
12
0-2.5 2.5-5 5-7.5 7.5-10 10-12.5 12.5-15 15-17.5 25-27.5
Development
0
2
4
6
8
10
12
14
0-3 3-6 6-9 9-12 12-15 15-18
Support
Shape: 1.16 Shape: 0.71

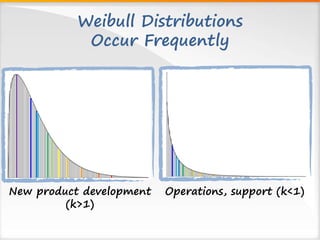

Weibull Distributions
Occur Frequently
Operations, support (k<1)New product development
(k>1)
Weibull Distributions
Occur Frequently
Operations, support (k<1)New product development
(k>1)
The unique signature
of your process
The unique signature
of your process
Bias
Feedback

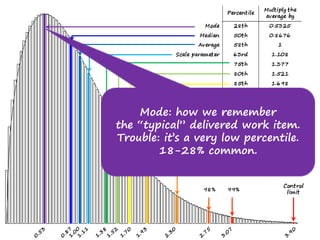

How to “Read” a Distribution
Scale
Control
Expectations
Forecast
Mode: how we remember
the “typical” delivered work item.
Trouble: it’s a very low percentile.
18-28% common.

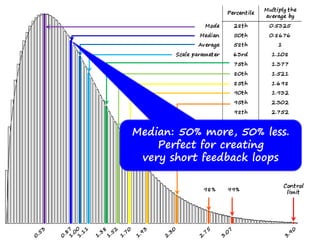

Median: 50% more, 50% less.
Perfect for creating
very short feedback loops

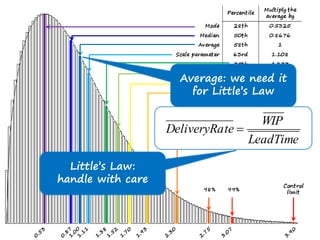

Average: we need it
for Little’s Law
LeadTime
WIP
teDeliveryRa 
Little’s Law:

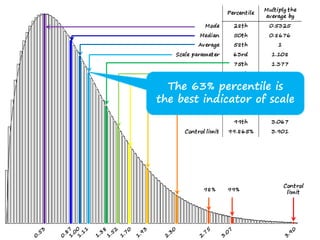

handle with care
The 63% percentile is
the best indicator of scale

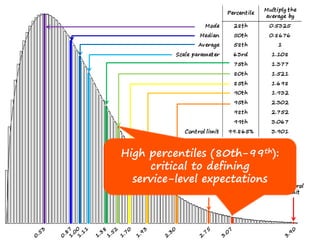

High percentiles (80th-99th):
critical to defining
service-level expectations
High percentiles (80th-99th):
critical to defining
service-level expectations

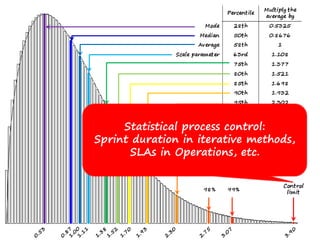

Statistical process control:
Sprint duration in iterative methods,
SLAs in Operations, etc.

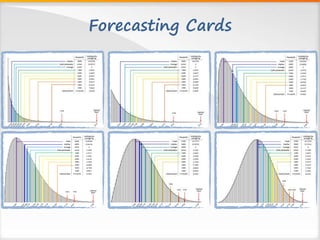

Forecasting Cards
While I Was Preparing This Presentation,
Somebody Sent Me This...
Discussion 4:
Probabilistic or Deterministic?
• Would you describe the prevailing approach in
your organization as probabilistic or
deterministic?
• Is the expected answer to “how long will it take?”
a single number?
• Can you instead ask, “when do we need it?” and
“when should we start?”
• Can you make decisions given distributions of
probabilities?
Test
Ready
S
R
Q
P
O
N
F

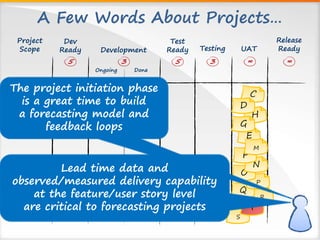

A Few Words About Projects…
E
I
G
D
M
Dev
Ready
5
Ongoing
Development Testing
Done
3 35
UAT
Release
Ready
∞ ∞
Project
Scope
Official training material, used with permission
Delivery Rate
Lead Time
WIP
=
Applying Little’s Law
From observed
capability
Treat as a fixed
variable
Target
to
achieve plan
Calculated based on
known lead time
capability & required
delivery rate
Determines
staffing level
Official training material, used with permission
Delivery Rate
Lead Time
WIP
=
Applying Little’s Law
From observed
capability
Treat as a fixed
variable
Target
to
achieve plan
Calculated based on
known lead time
capability & required
delivery rate
Determines
staffing level
Complicating factors here:
Dark matter
“Z-curve effect”
Scope creep
Complicating factors here:
Variety of work item types and risks
Test
Ready
S
R
Q
P
O
N
F
A Few Words About Projects…
E
I
G
D
M
Dev
Ready
5
Ongoing
Development Testing
Done
3 35
UAT
Release
Ready
∞ ∞
Project
Scope
Lead time data and
observed/measured delivery capability
at the feature/user story level
are critical to forecasting projects
The project initiation phase
is a great time to build
a forecasting model and
feedback loops
New Kanban Book
Mike Burrows
Influencers
Troy Magennis Dimitar Bakardzhiev David J Anderson
Dan Vacanti Dave White Frank Vega
Discussion 5: What Now?
• What new ideas have your learned in this
session today?
• What will you do differently when you return to
your office tomorrow?
Alexei Zheglov
connected-knowledge.com (blog)
alex@LeanAtoZ.com
@az1

Lead Time: What We Know About It...
