Flow Product
Development
Pablo Domingo
@pavleras
Principles
Variability
Queues & Resource Efficiency
Flow Product
Development
Principles

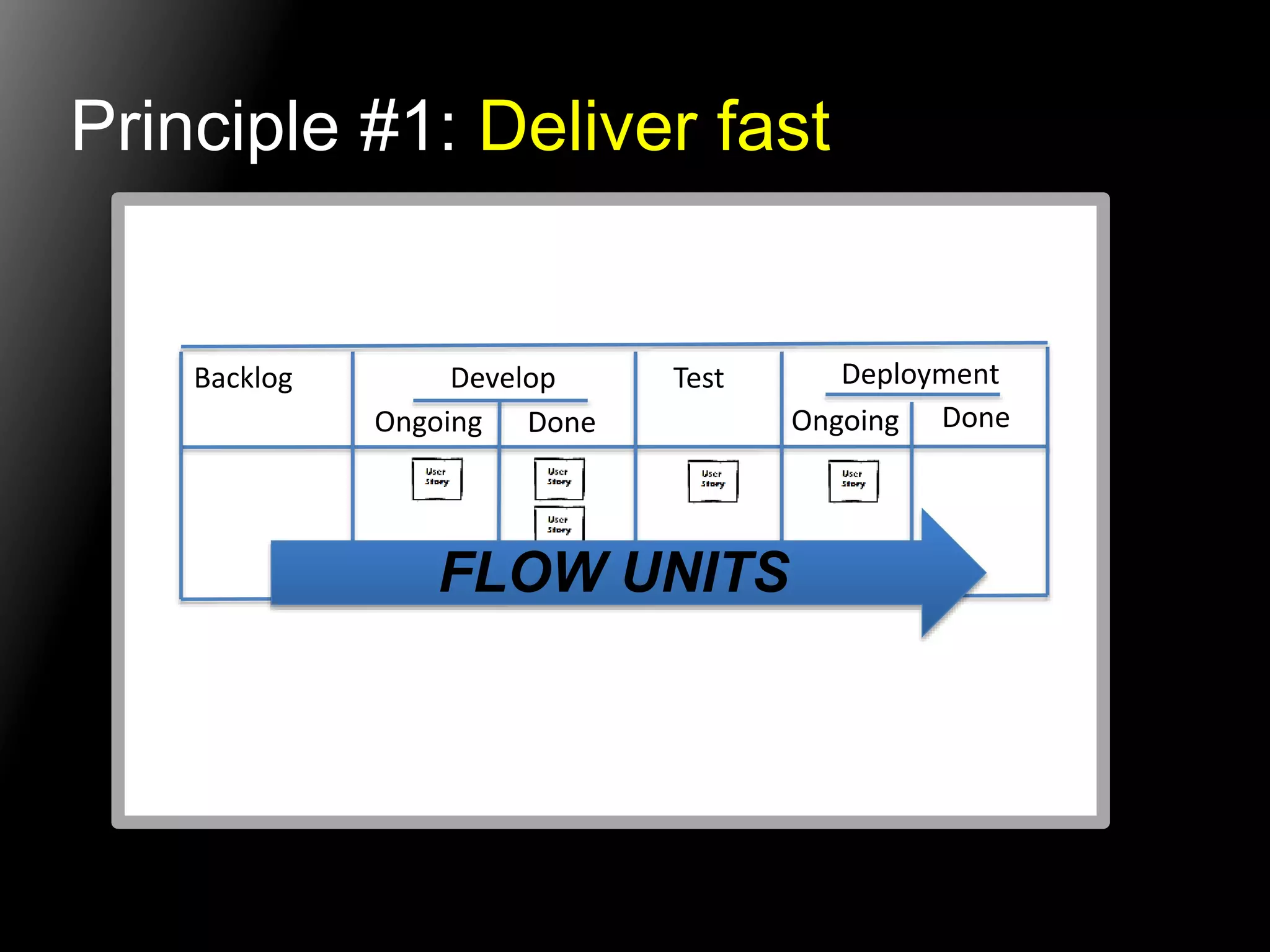

Principle #1: Deliver fast
Principle #1: Deliver fast

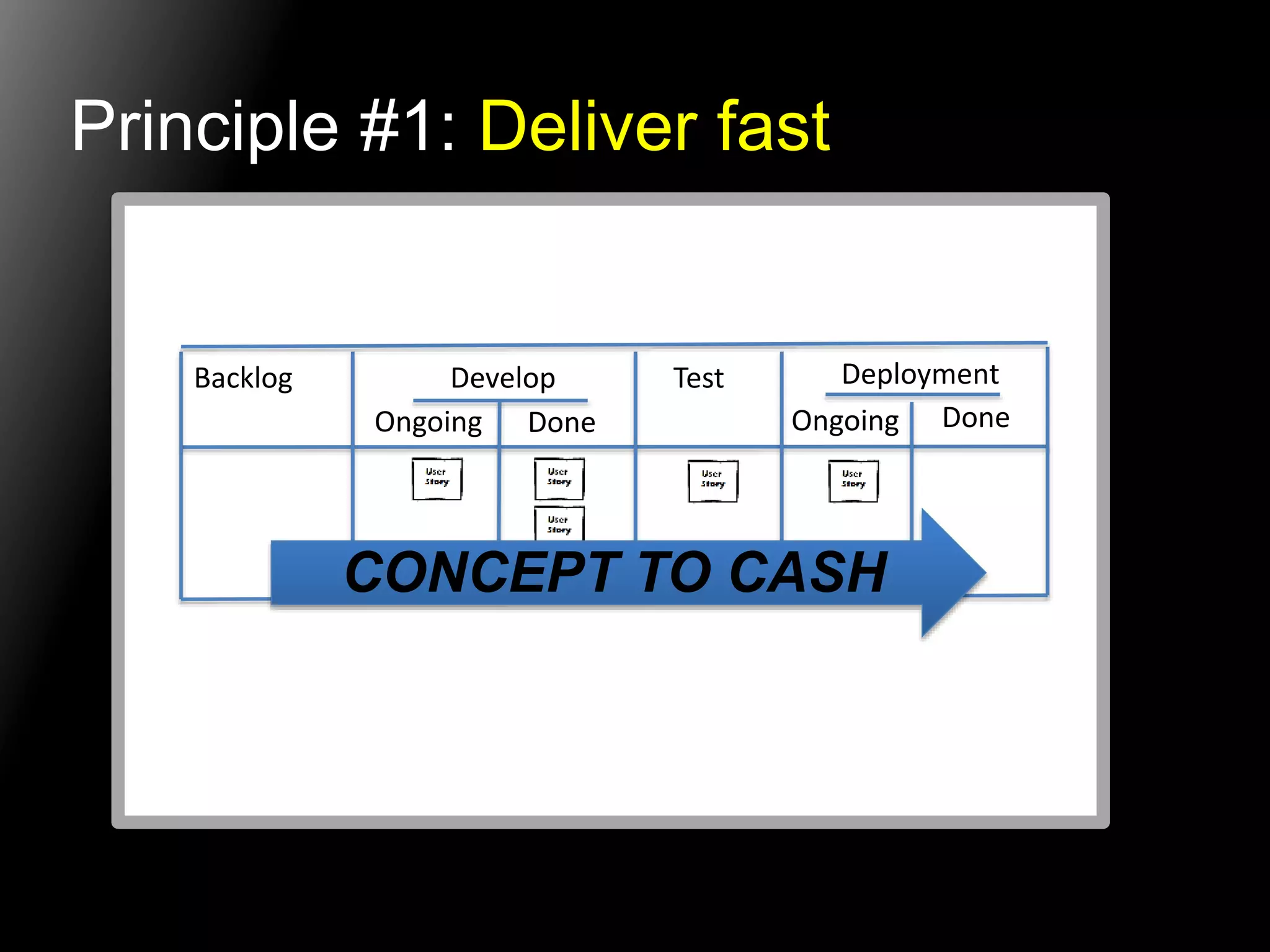

Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
FLOW UNITS
Principle #1: Deliver fast
Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
CONCEPT TO CASH
Principle #2: Eliminate non-value
added activities.
https://www.flickr.com/people/92944716@N05/
Only give
me good
news
Principle #2: Eliminate non-value
added activities.
https://www.flickr.com/photos/st3f4n/4487662126/

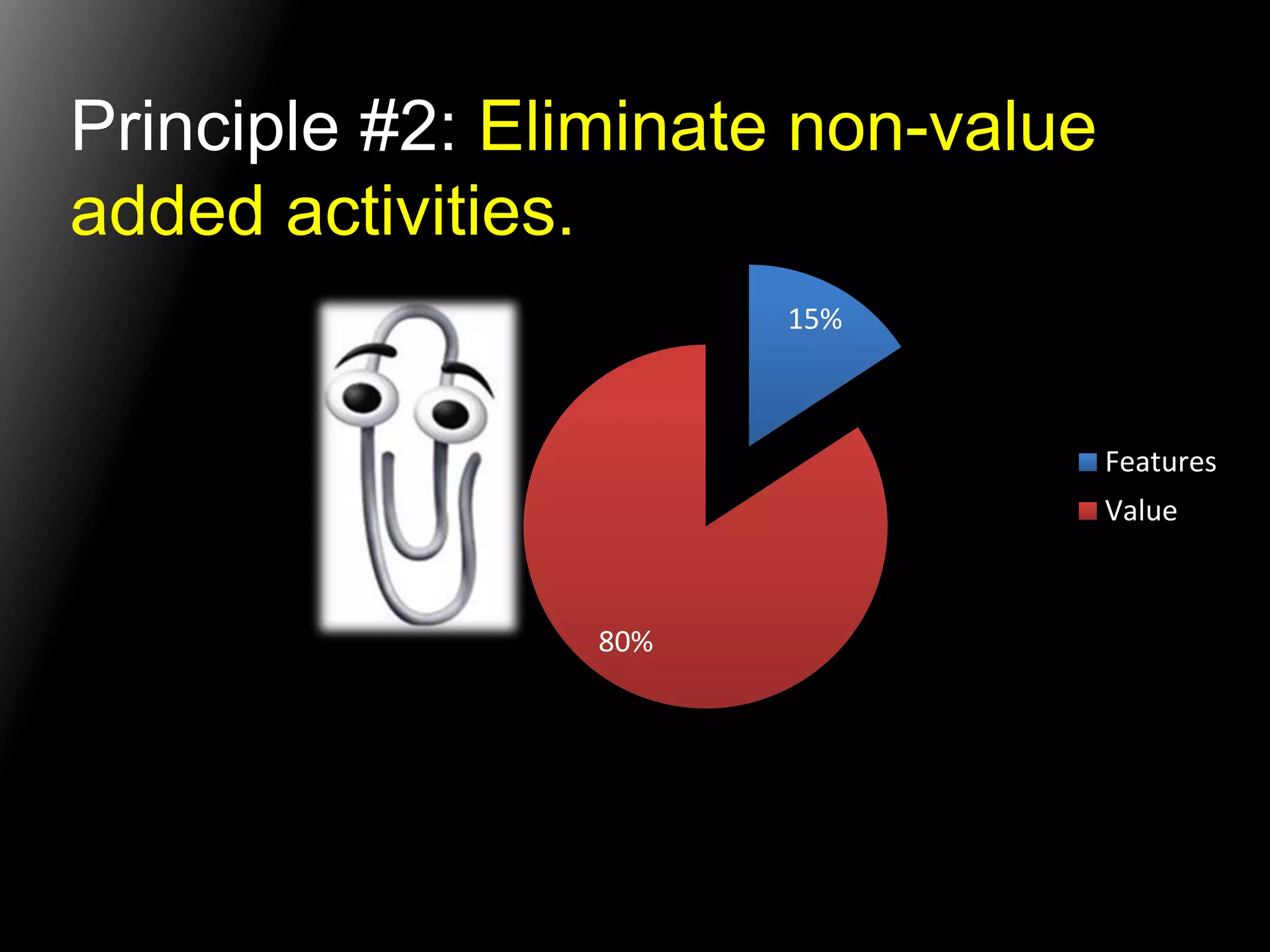

Principle #2: Eliminate non-value
added activities.
15%
80%
Features
Value
Principle #2: Eliminate non-value
added activities.
Principle #2: Eliminate non-value
added activities.
http://www.heraldo.es/galerias-imagenes/chapuzas-en-aragon/#2

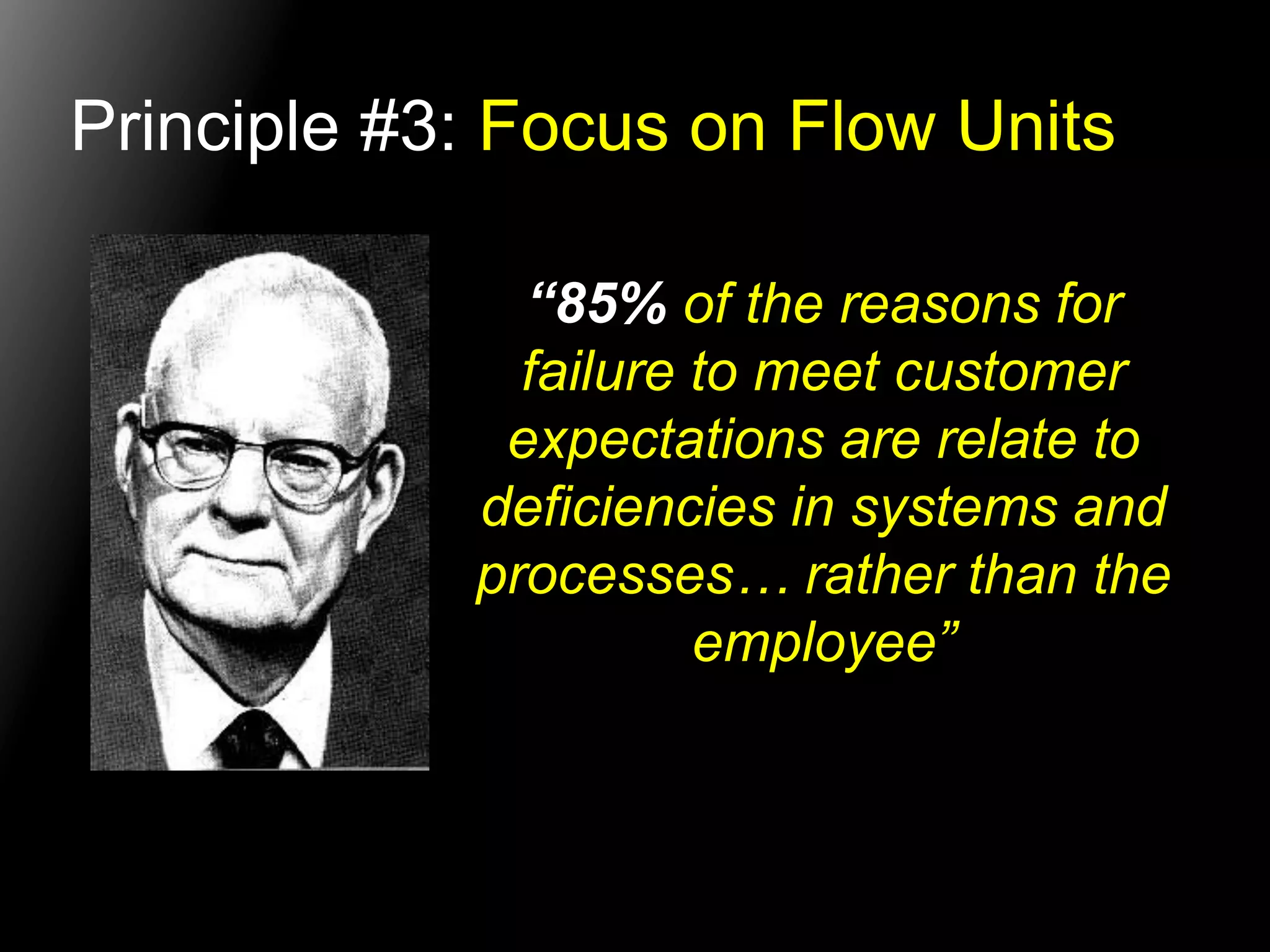

Principle #3: Focus on Flow Units
“85% of the reasons for
failure to meet customer
expectations are relate to
deficiencies in systems and
processes… rather than the
employee”
Flow Product
Development
Variability
#1: Variability
https://www.flickr.com/photos/donsolo/2332814270/
Variability – Lean Manufacturing
You cannot add value without
adding variability
https://www.flickr.com/photos/urbangarden/

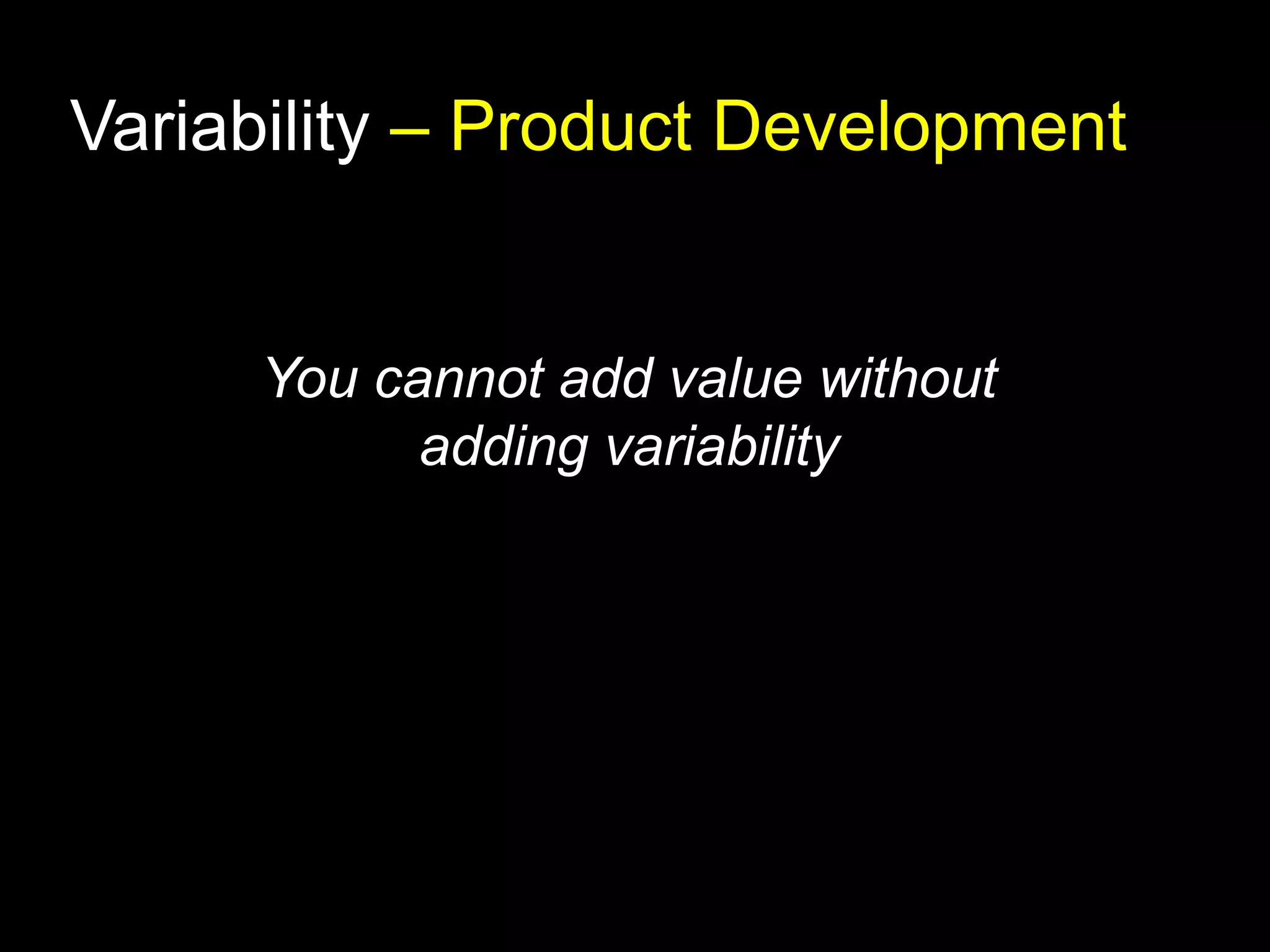

Variability – Product Development
You cannot add value without
adding variability
Variability – Product Development
You cannot add value without
adding variability but you can add
variability without adding value
Donald Reinertsen
#1 Histograms
Time
Cycle Time
12
10
Cycle Time
8
6
4
2
0

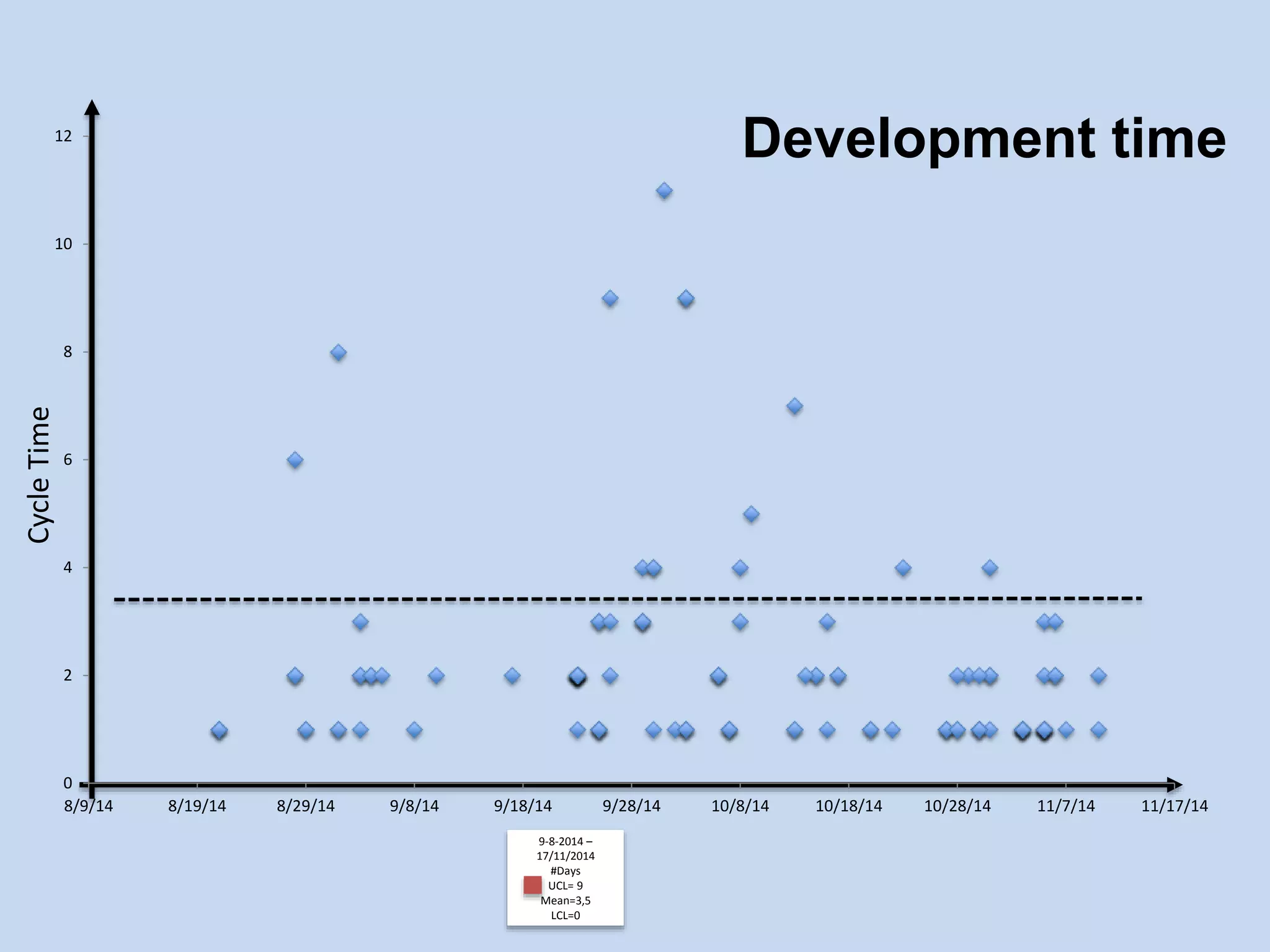

Development time
8/9/14 8/19/14 8/29/14 9/8/14 9/18/14 9/28/14 10/8/14 10/18/14 10/28/14 11/7/14 11/17/14
9-8-2014 –
17/11/2014
#Days
UCL= 9
Mean=3,5
LCL=0
12
10
Cycle Time
8
6
4
2
0

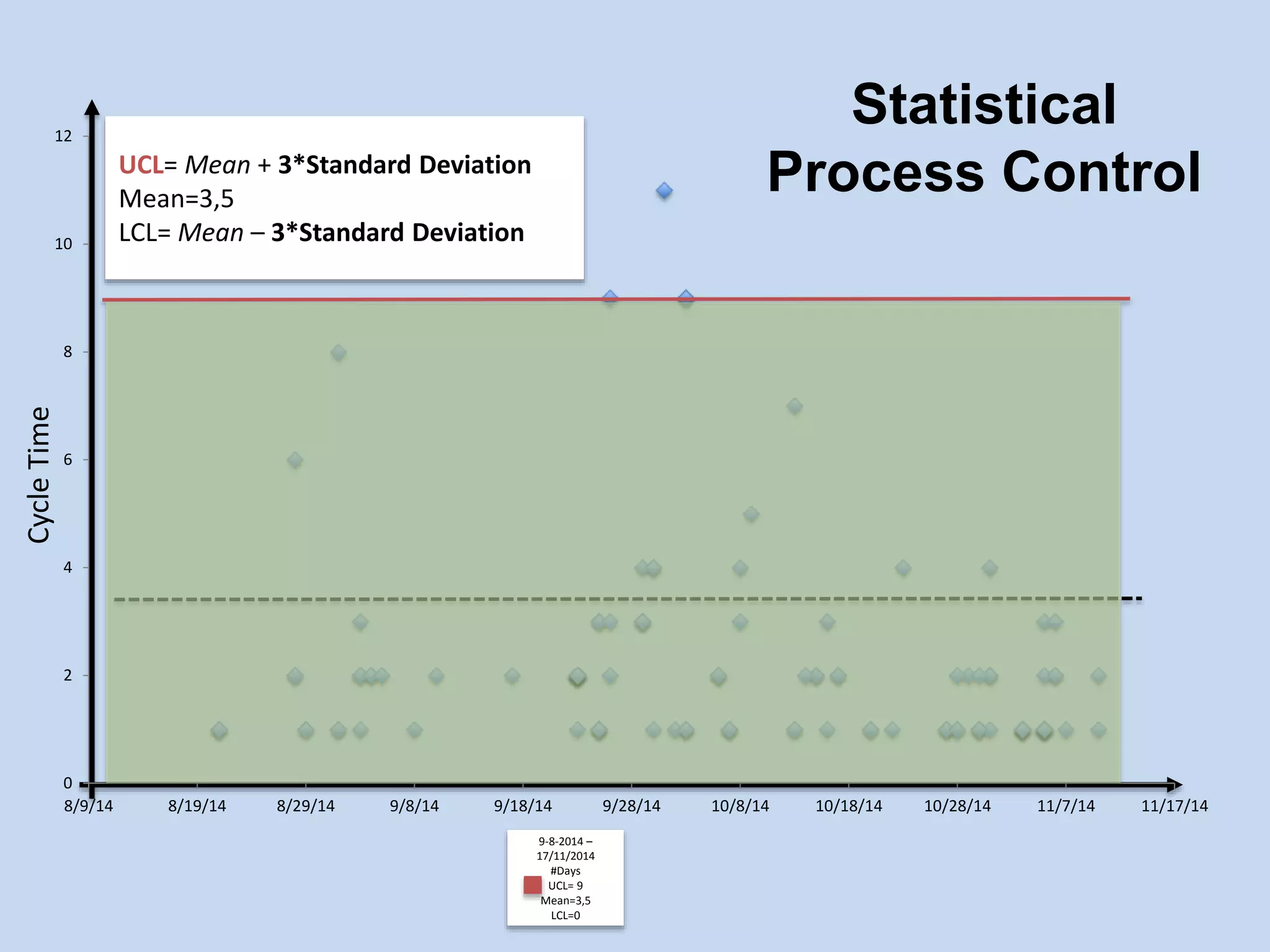

Statistical
Process Control
8/9/14 8/19/14 8/29/14 9/8/14 9/18/14 9/28/14 10/8/14 10/18/14 10/28/14 11/7/14 11/17/14
9-8-2014 –
17/11/2014
#Days
UCL= 9
Mean=3,5
LCL=0
UCL= Mean + 3*Standard Deviation
Mean=3,5
LCL= Mean – 3*Standard Deviation
12
10
Cycle Time
8
6
4
2
0

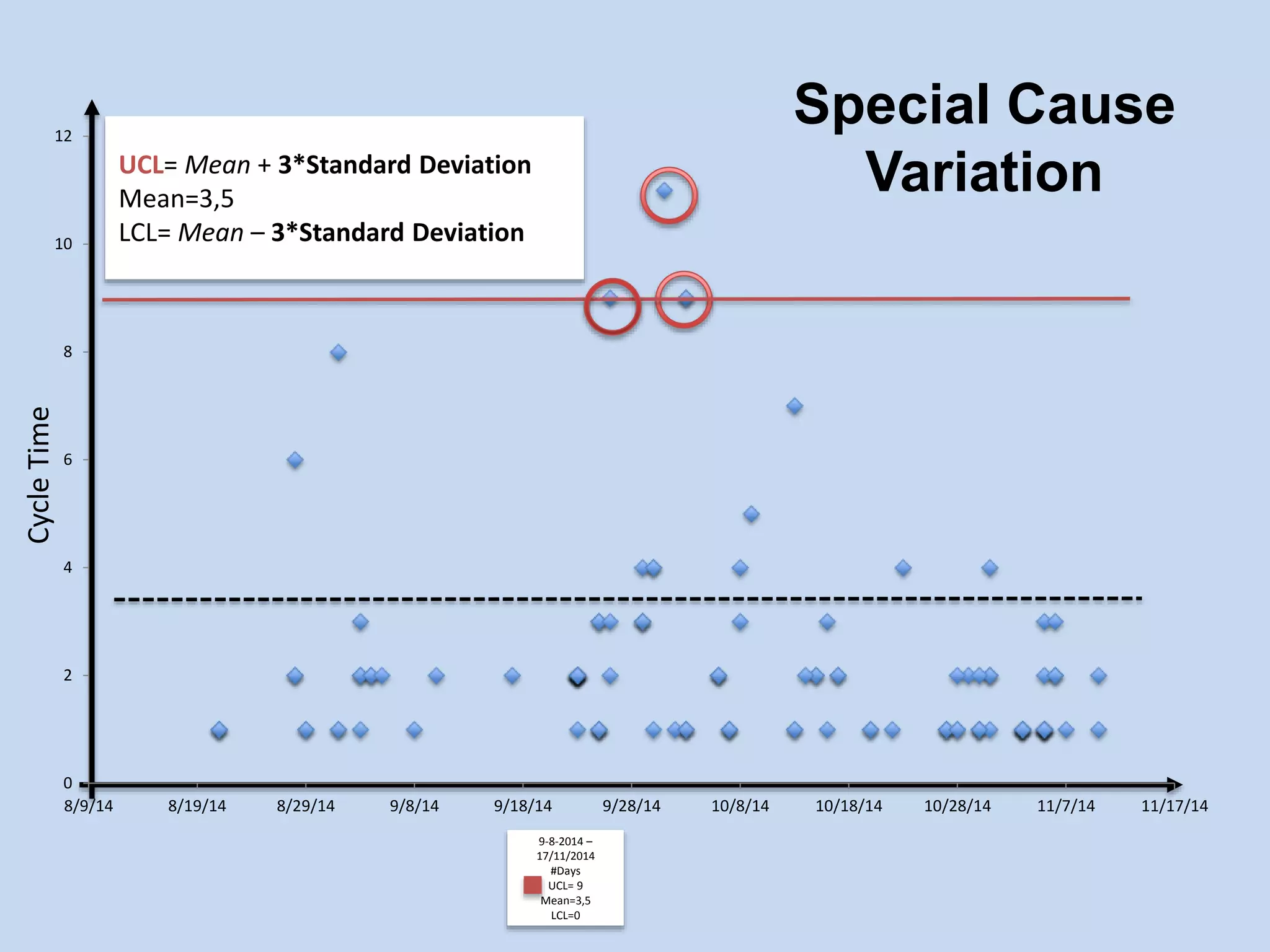

Special Cause
Variation
8/9/14 8/19/14 8/29/14 9/8/14 9/18/14 9/28/14 10/8/14 10/18/14 10/28/14 11/7/14 11/17/14
9-8-2014 –
17/11/2014
#Days
UCL= 9
Mean=3,5
LCL=0
UCL= Mean + 3*Standard Deviation
Mean=3,5
LCL= Mean – 3*Standard Deviation

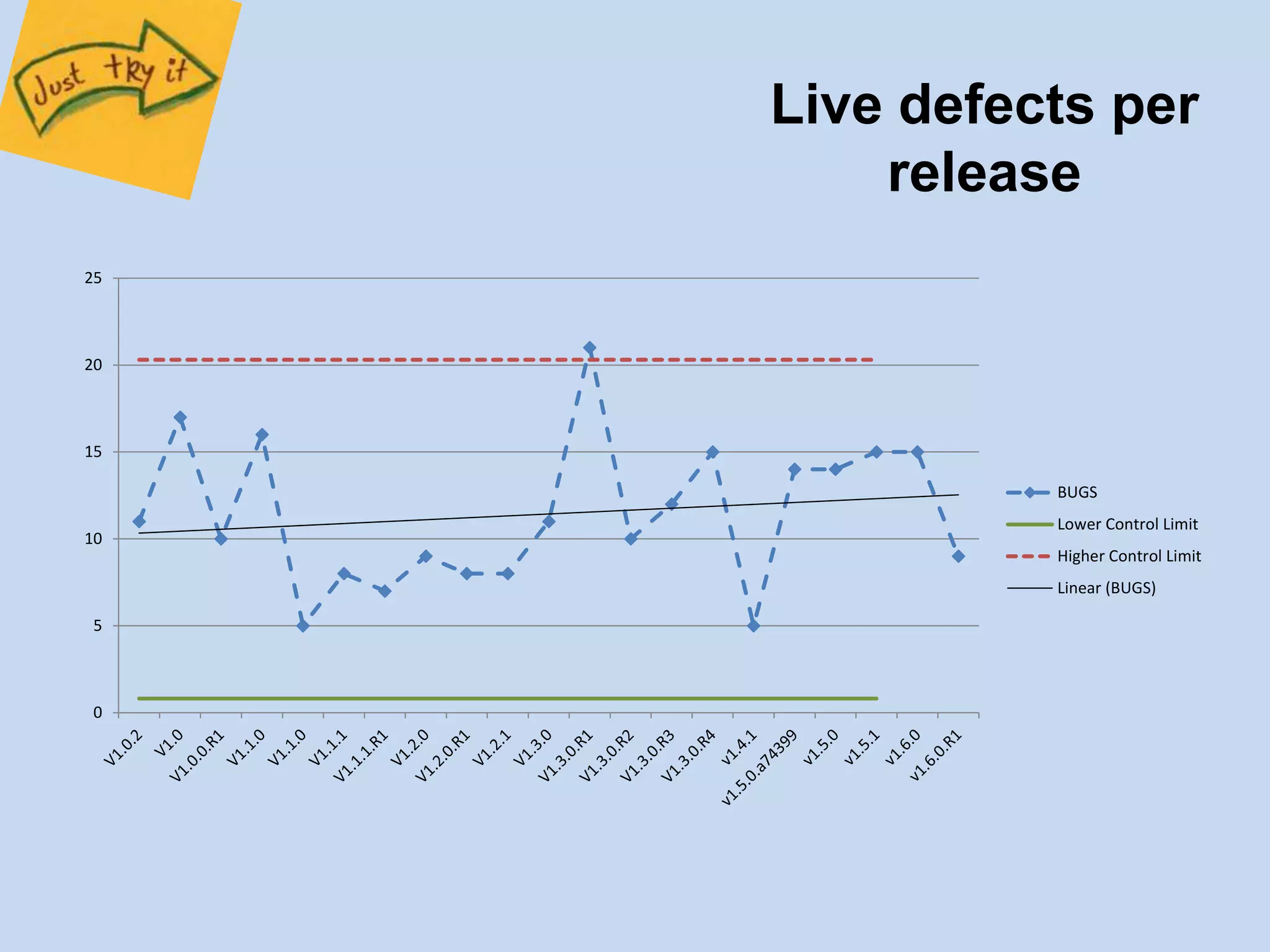

Live defects per
release
25
20
15
10
5
0
BUGS
Lower Control Limit
Higher Control Limit
Linear (BUGS)
25
20
15
10
5
0
“Voice of the
process”
BUGS
Lower Control Limit
Higher Control Limit
Linear (BUGS)

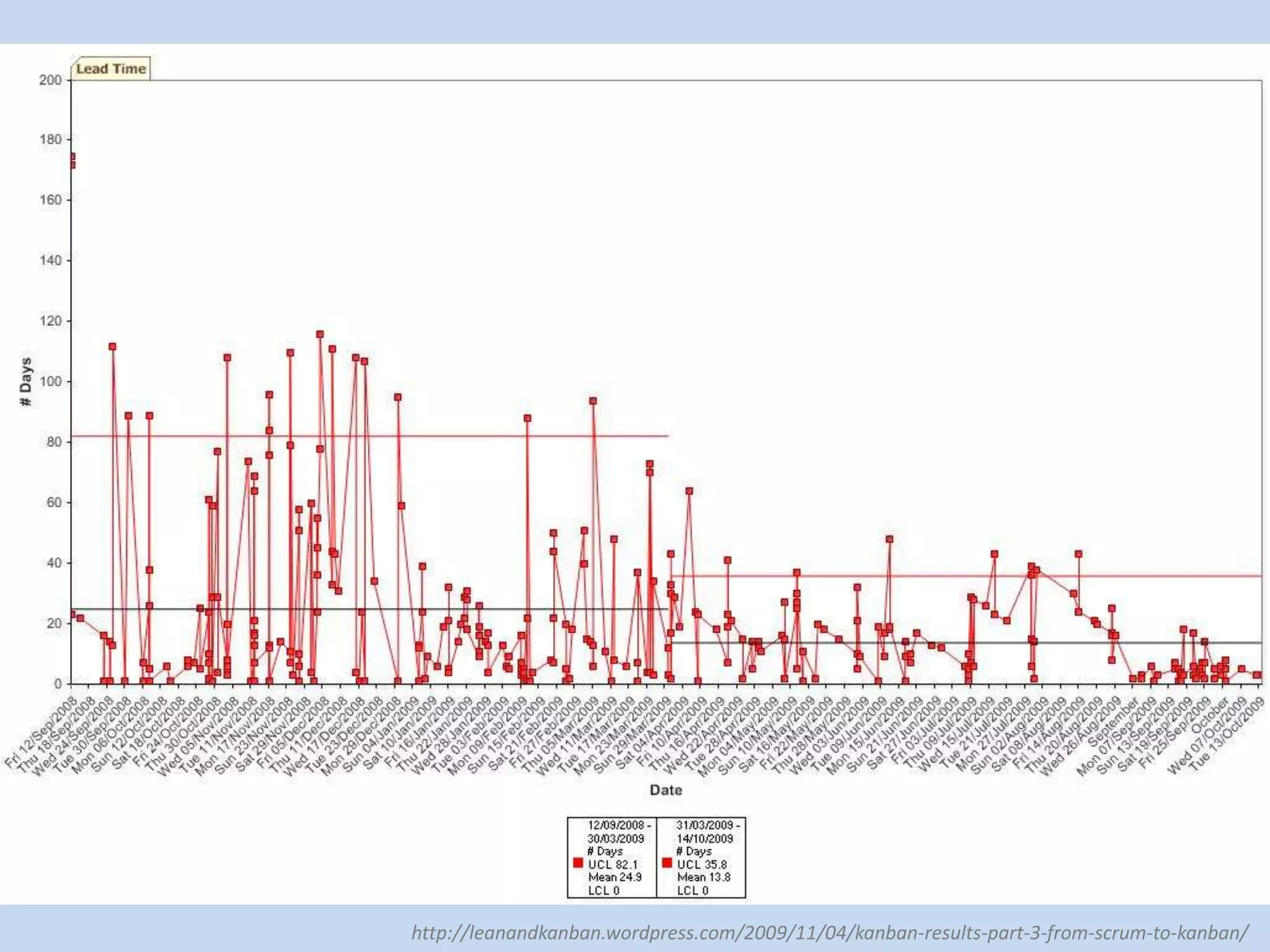

http://leanandkanban.wordpress.com/2009/11/04/kanban-results-part-3-from-scrum-to-kanban/
Flow Product
Development
Queues & Resource Efficiency
#2: Queues &
Resource Efficiency
https://www.flickr.com/photos/donsolo/2332814270/

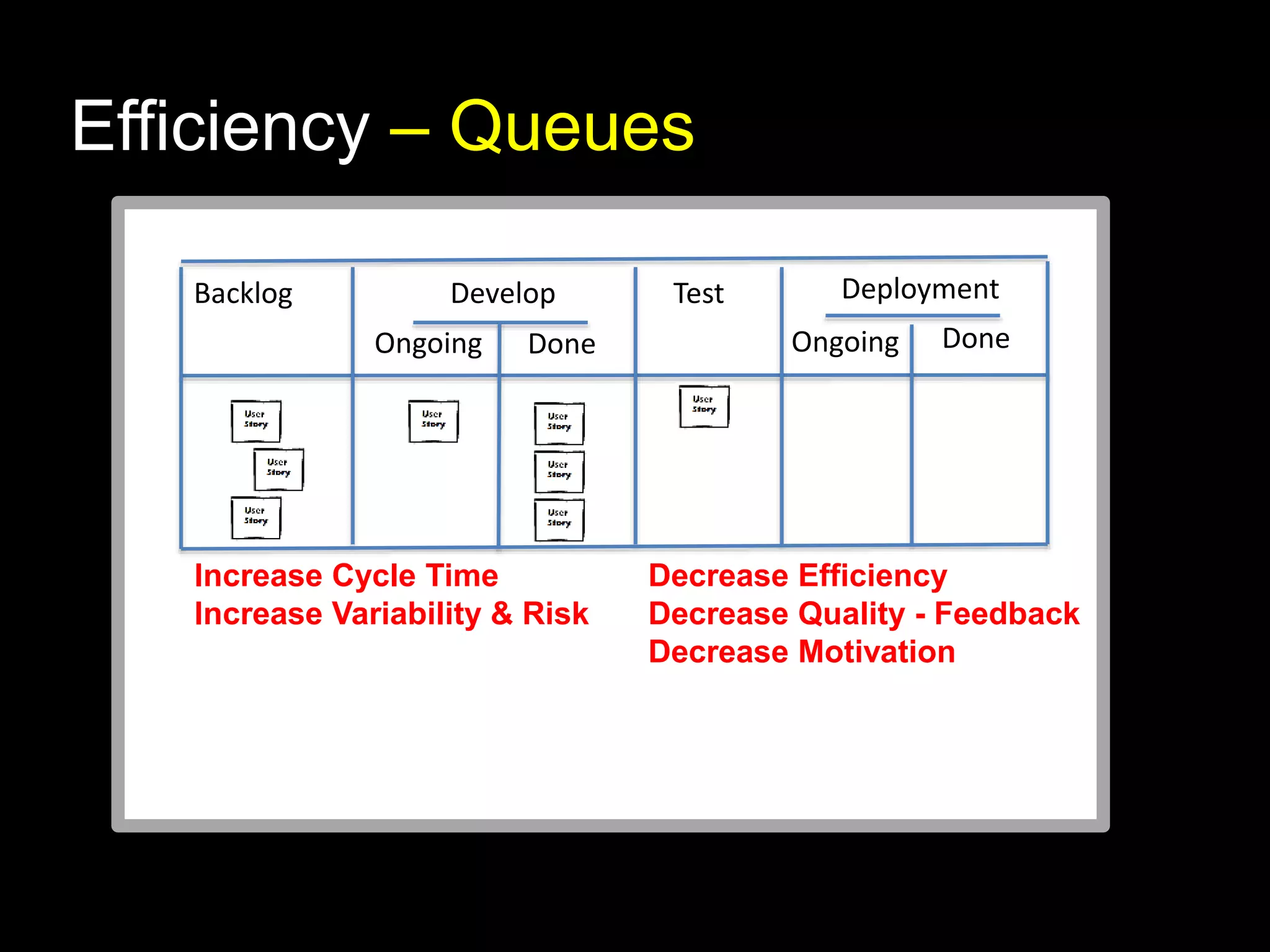

Efficiency – Queues

Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
Increase Cycle Time
Increase Variability & Risk
Decrease Efficiency
Decrease Quality - Feedback
Decrease Motivation
Efficiency – Queues
https://www.flickr.com/photos/wwarby/11682625885/
Efficiency – Queuing Theory
Queues + Variability + Resource
efficiency?
https://www.flickr.com/photos/skycaptaintwo/

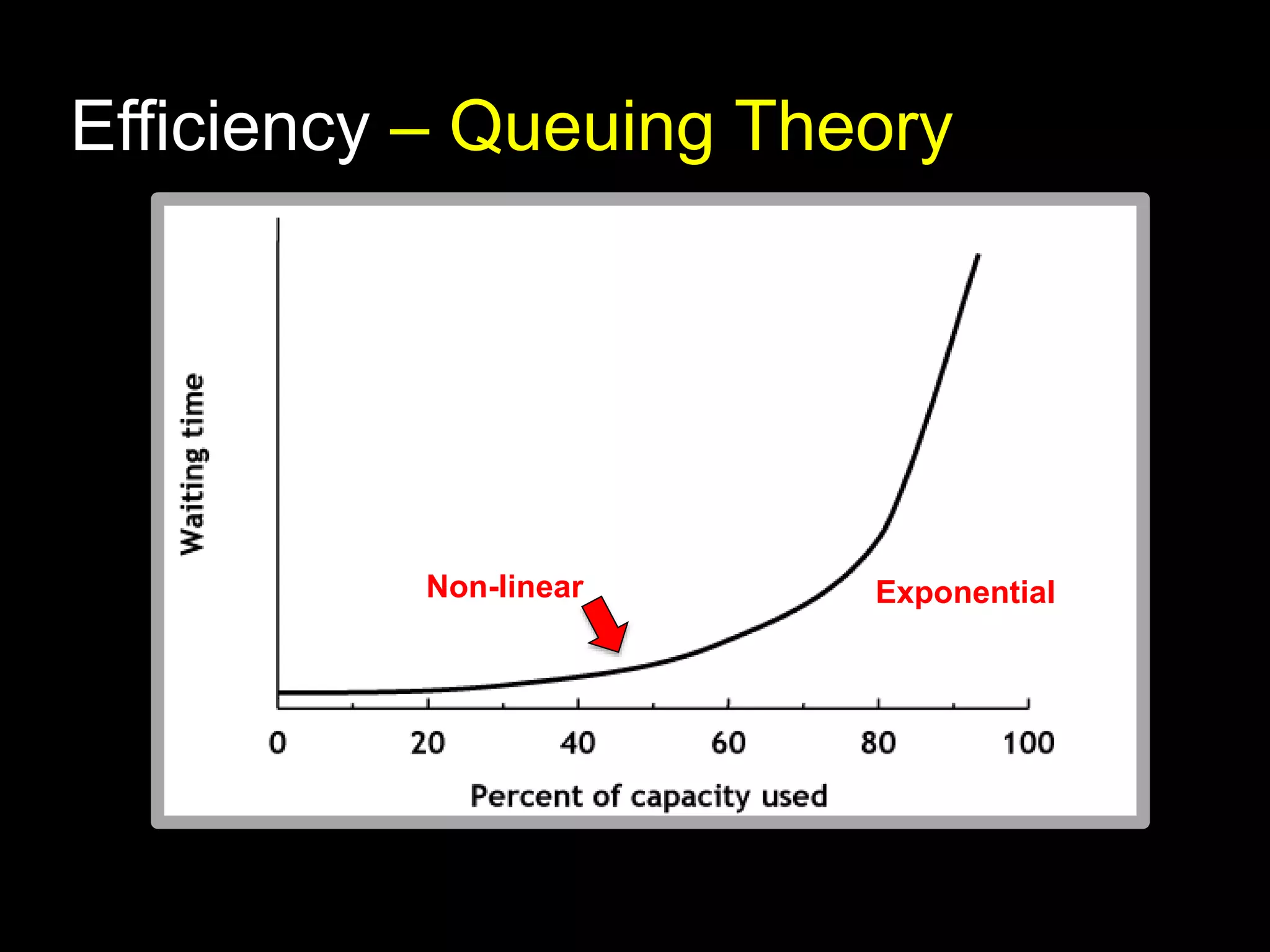

Efficiency – Queuing Theory

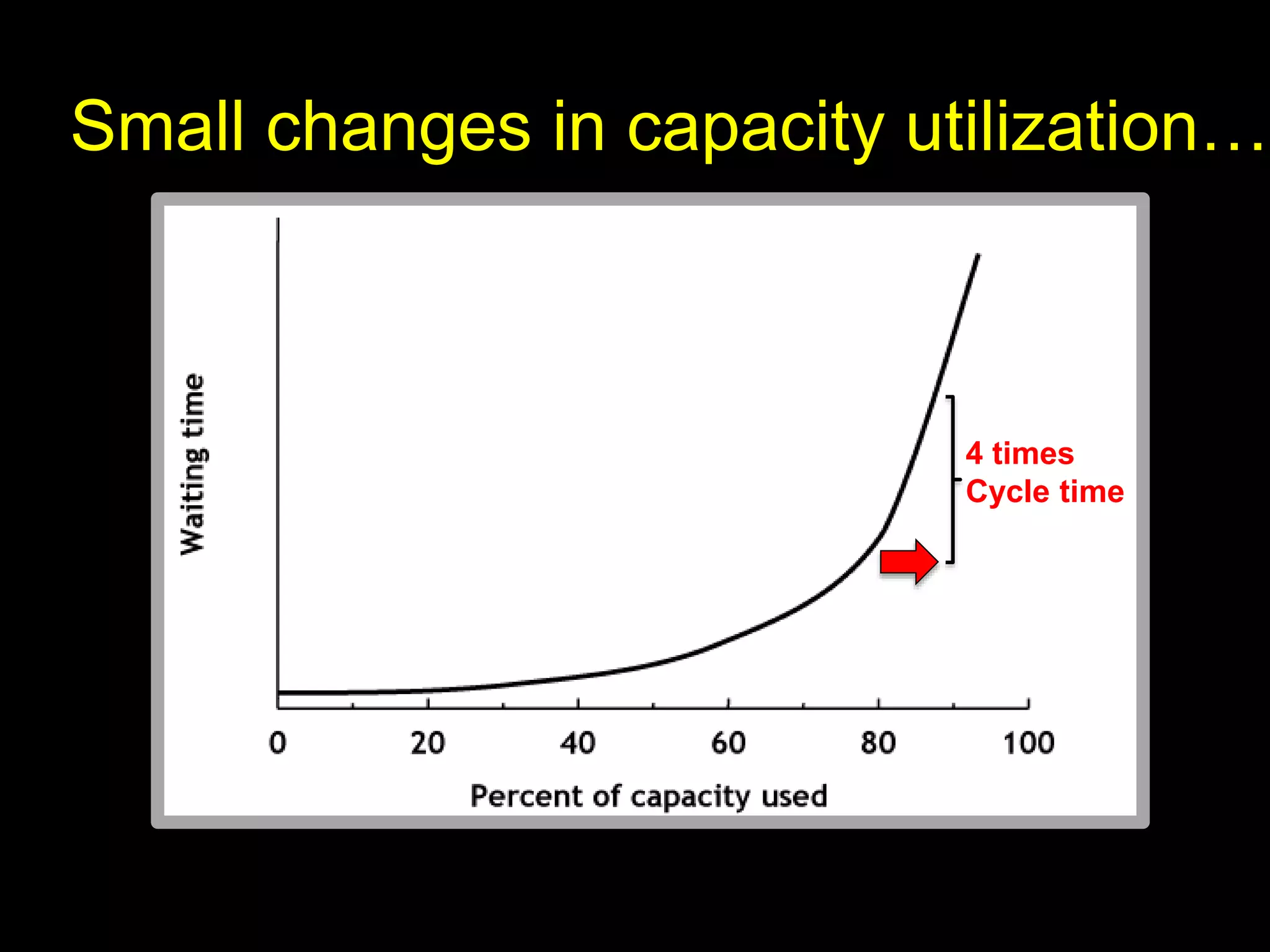

Non-linear Exponential
Small changes in capacity utilization…
4 times
Cycle time
Tool:#2

Cumulative Flow Diagram
Time
Cumulative size
Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
6
5
4
3
2
1
0
12/8/14	 12/8/14
Ready	To	Do
In	progress
Test
Deploy
Complete
Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
6
5
4
3
2
1
0

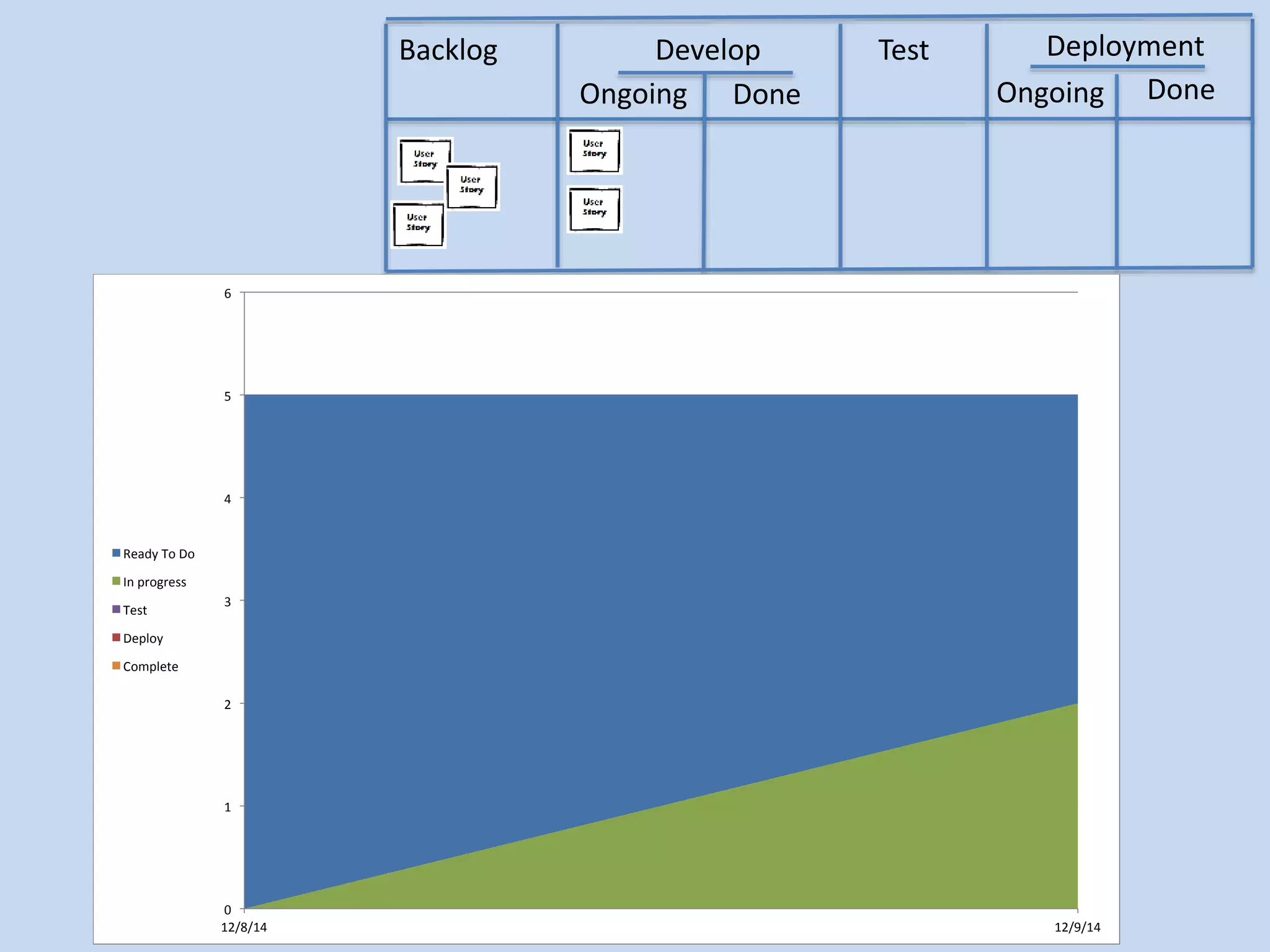

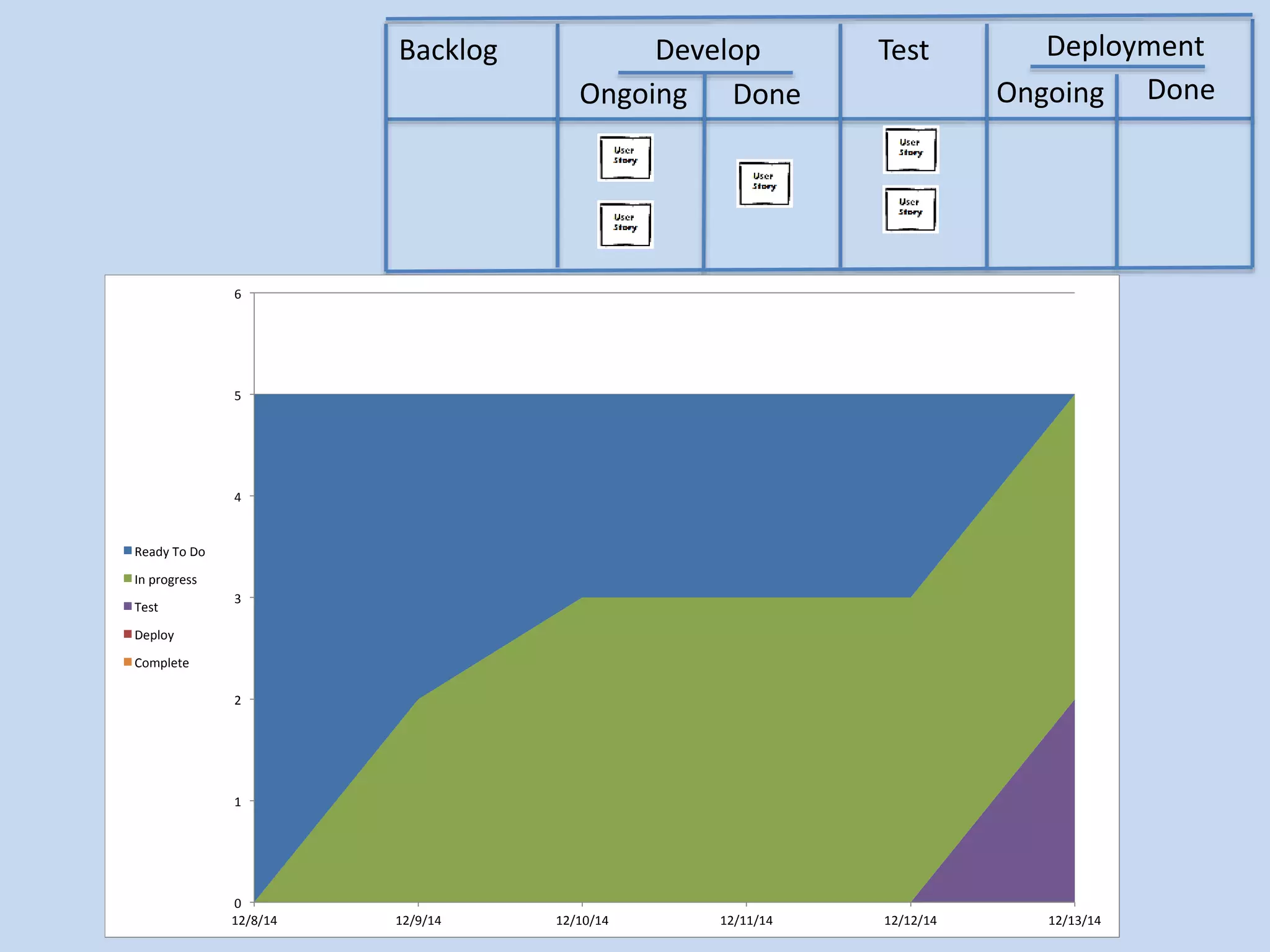

12/8/14	 12/9/14
Ready	To	Do
In	progress
Test
Deploy
Complete

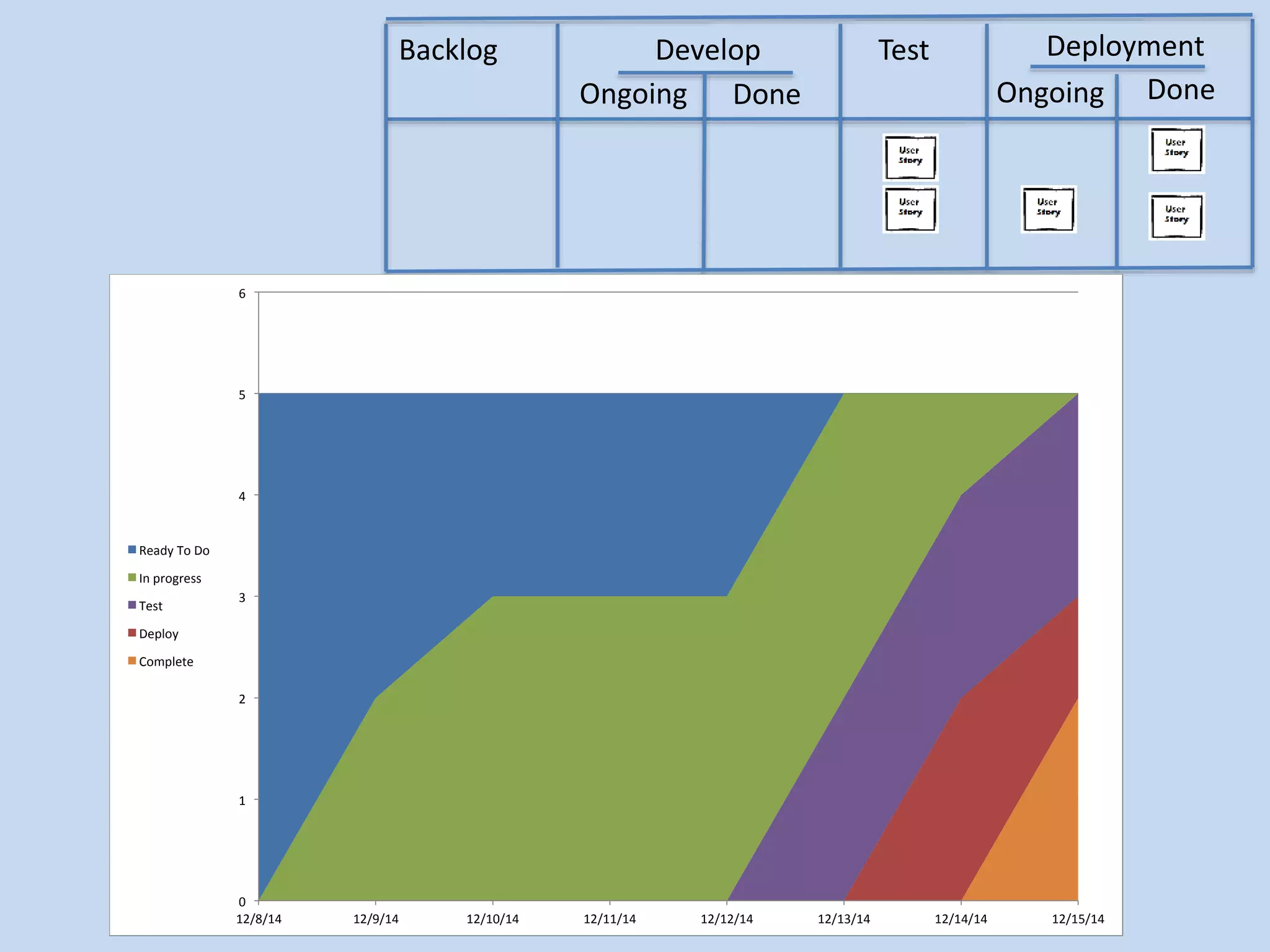

Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
6
5
4
3
2
1
0

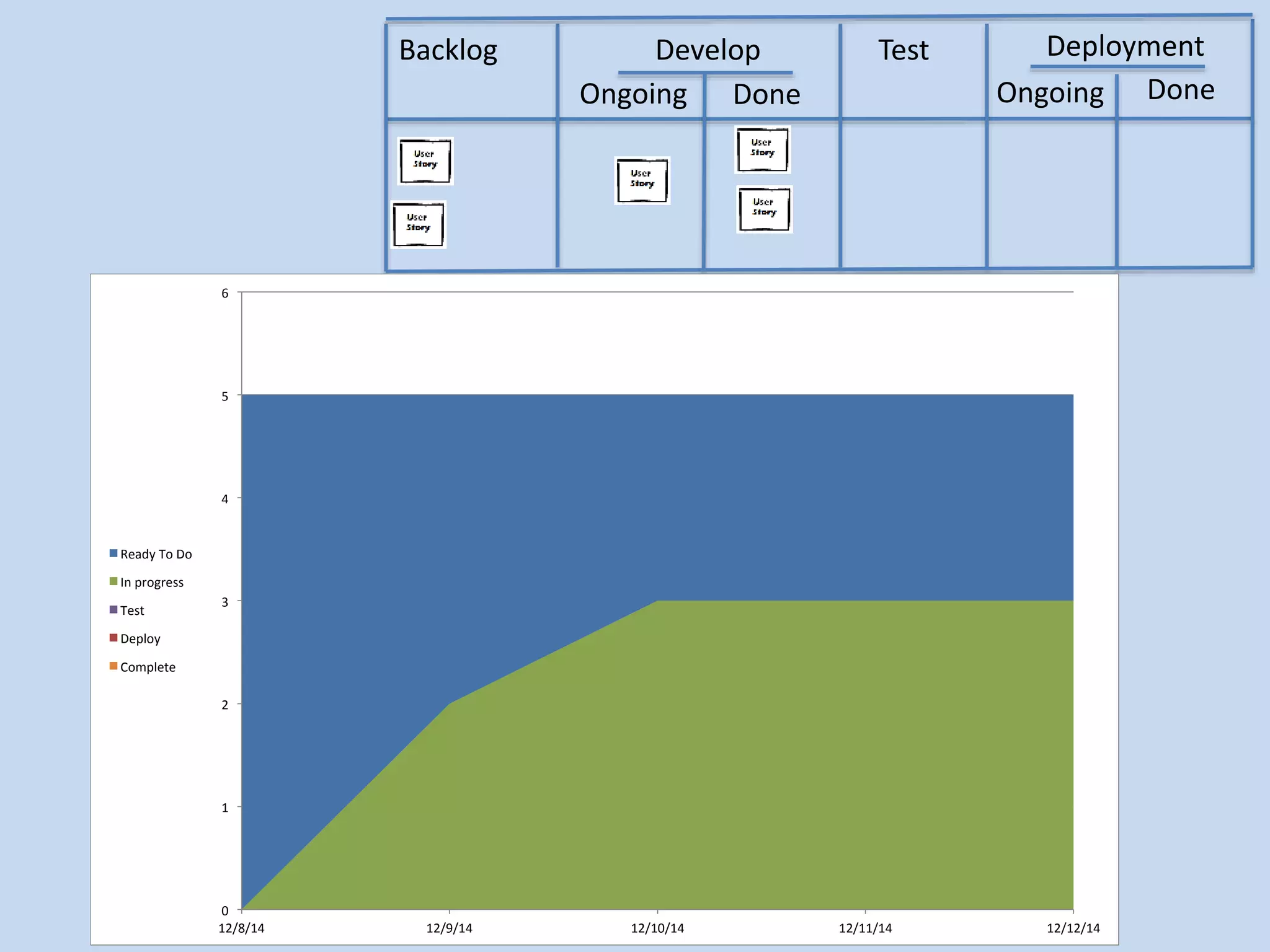

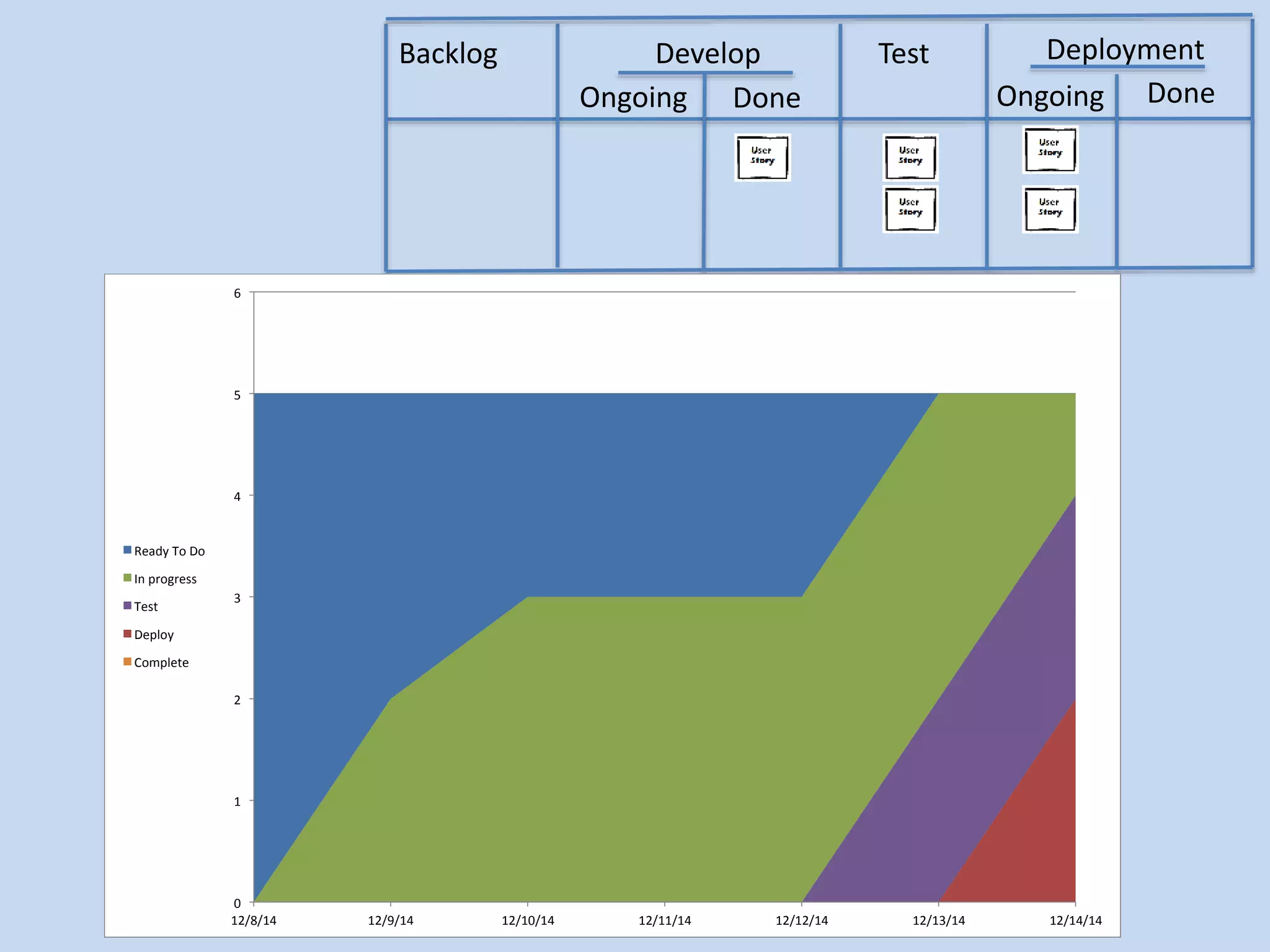

12/8/14	 12/9/14	 12/10/14	 12/11/14	 12/12/14
Ready	To	Do
In	progress
Test
Deploy
Complete
Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
6
5
4
3
2
1
0
12/8/14	 12/9/14	 12/10/14	 12/11/14	 12/12/14	 12/13/14
Ready	To	Do
In	progress
Test
Deploy
Complete
Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
6
5
4
3
2
1
0
12/8/14	 12/9/14	 12/10/14	 12/11/14	 12/12/14	 12/13/14	 12/14/14
Ready	To	Do
In	progress
Test
Deploy
Complete
Backlog Develop
Ongoing Done
Test Deployment
Ongoing Done
6
5
4
3
2
1
0
12/8/14	 12/9/14	 12/10/14	 12/11/14	 12/12/14	 12/13/14	 12/14/14	 12/15/14
Ready	To	Do
In	progress
Test
Deploy
Complete
35
30
25
20
15
10
5
0
8/20/14	 8/21/14	 8/22/14	 8/25/14	 8/26/14	 8/27/14	 8/28/14	 8/29/14	 9/1/14	 9/2/14	 9/3/14	 9/4/14	 9/5/14	 9/8/14	 9/9/14
Ready
Design
Implement
Verify
Deploy
Complete

CYCLE TIME
35
30
25
20
15
10
5
0
8/20/14	 8/21/14	 8/22/14	 8/25/14	 8/26/14	 8/27/14	 8/28/14	 8/29/14	 9/1/14	 9/2/14	 9/3/14	 9/4/14	 9/5/14	 9/8/14	 9/9/14
Ready
Design
Implement
Verify
Deploy
Complete

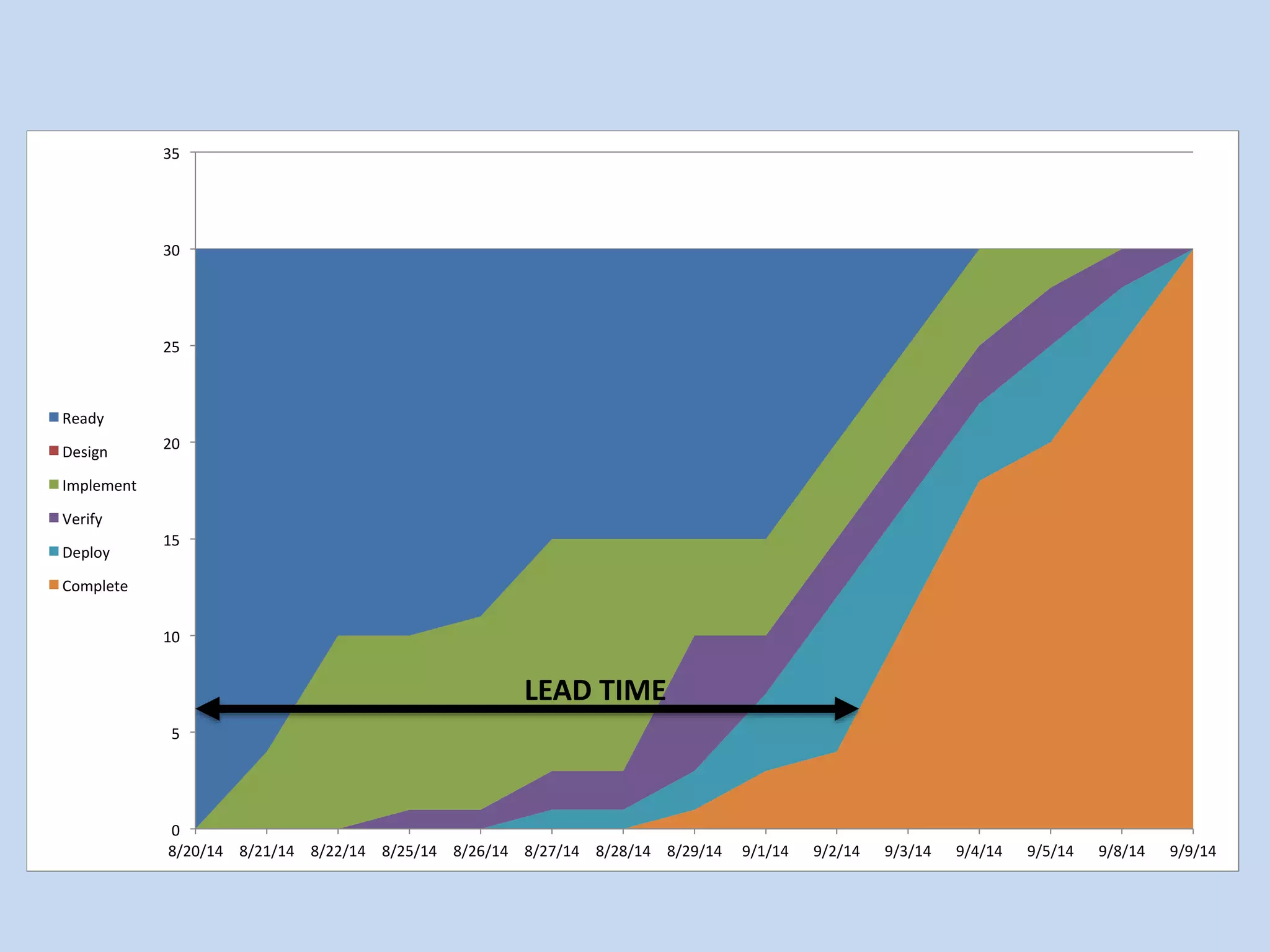

LEAD TIME
35
30
25
20
15
10
5
0
8/20/14	 8/21/14	 8/22/14	 8/25/14	 8/26/14	 8/27/14	 8/28/14	 8/29/14	 9/1/14	 9/2/14	 9/3/14	 9/4/14	 9/5/14	 9/8/14	 9/9/14
Ready
Design
Implement
Verify
Deploy
Complete
Limiting WIP?
QUANTITY IN
QUEUE
35
30
25
20
15
10
5
0
8/20/14	 8/21/14	 8/22/14	 8/25/14	 8/26/14	 8/27/14	 8/28/14	 8/29/14	 9/1/14	 9/2/14	 9/3/14	 9/4/14	 9/5/14	 9/8/14	 9/9/14
Ready
Design
Implement
Verify
Deploy
Complete
QUANTITY IN
QUEUE
WIP
Constraint
35
30
25
20
15
10
5
0
8/20/14	 8/21/14	 8/22/14	 8/25/14	 8/26/14	 8/27/14	 8/28/14	 8/29/14	 9/1/14	 9/2/14	 9/3/14	 9/4/14	 9/5/14	 9/8/14	 9/9/14
Ready
Design
Implement
Verify
Deploy
Complete
QUANTITY IN
QUEUE
WIP
Constraint
35
30
25
20
15
10
5
0

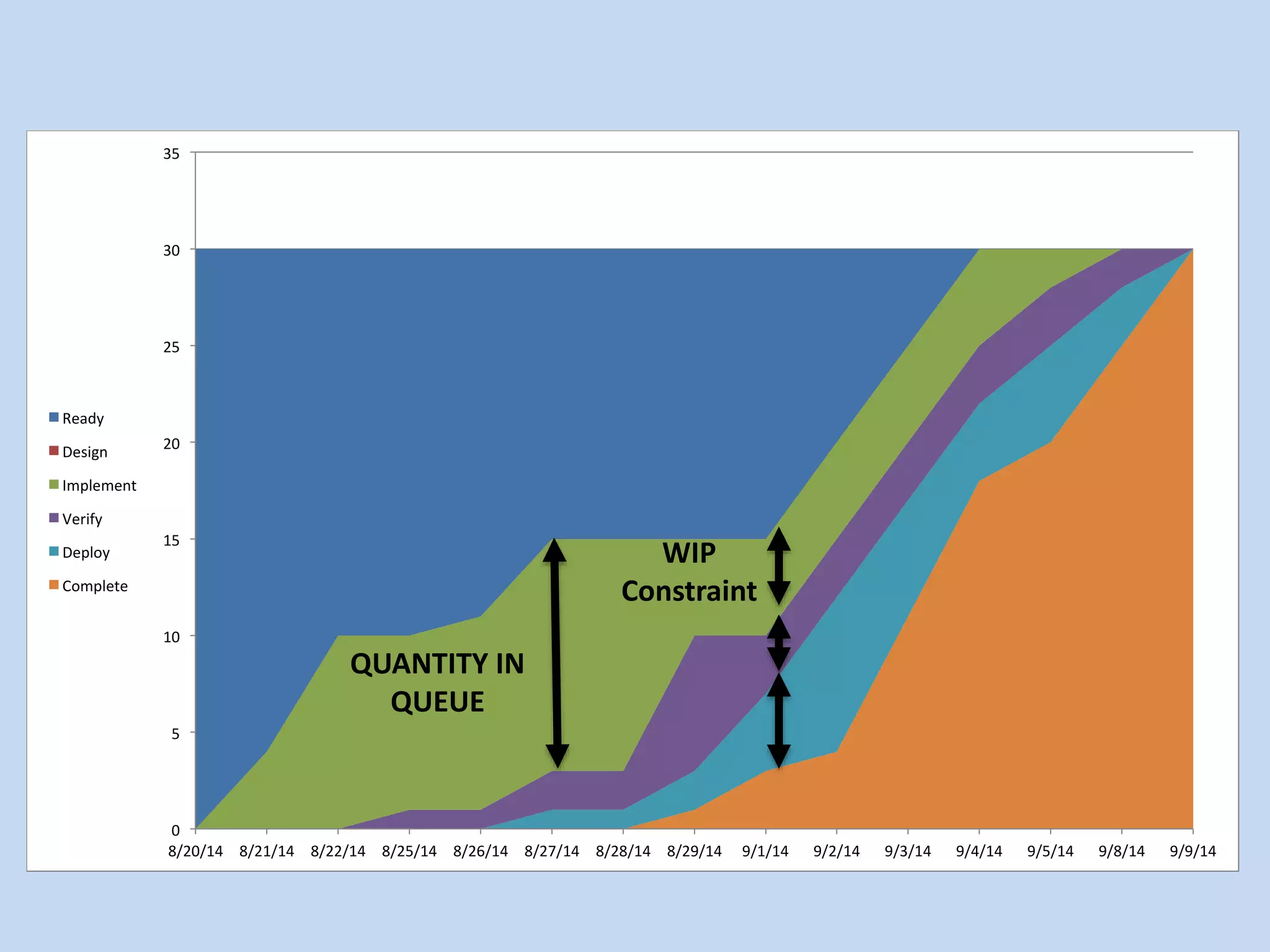

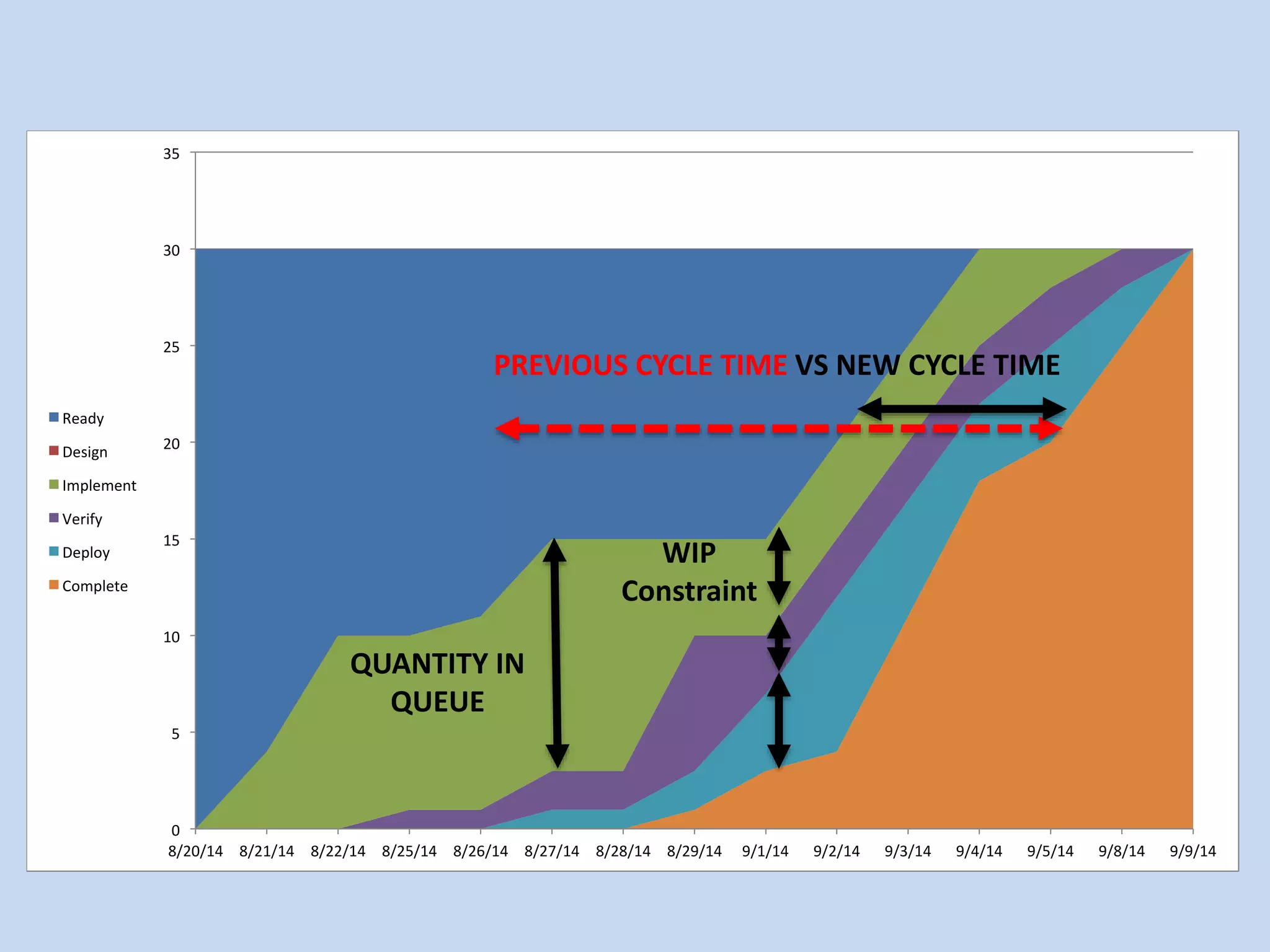

PREVIOUS CYCLE TIME VS NEW CYCLE TIME
8/20/14	 8/21/14	 8/22/14	 8/25/14	 8/26/14	 8/27/14	 8/28/14	 8/29/14	 9/1/14	 9/2/14	 9/3/14	 9/4/14	 9/5/14	 9/8/14	 9/9/14
Ready
Design
Implement
Verify
Deploy
Complete
QUANTITY IN
QUEUE
WIP
Constraint
Tool:#3
Little’s Formula
Manage Flow using Little’s law

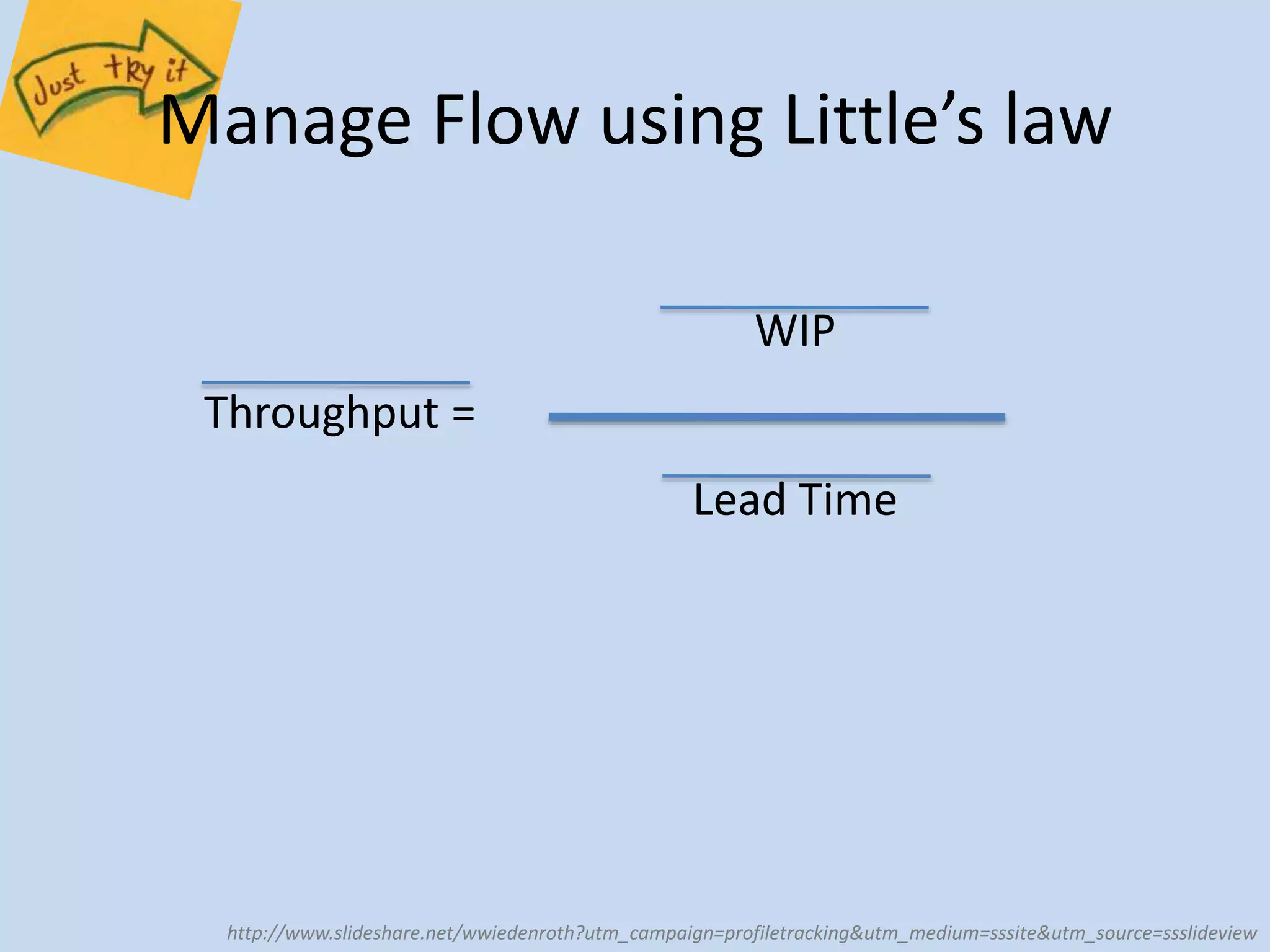

Throughput =
WIP
Lead Time
http://www.slideshare.net/wwiedenroth?utm_campaign=profiletracking&utm_medium=sssite&utm_source=ssslideview

Manage Flow using Little’s law
Calculate Project Lead Time
Project Lead Time = N. of Flow Units Average Lead Time
Average WIP
= 500
10 days
8 items
= 125 weeks
http://www.slideshare.net/wwiedenroth?utm_campaign=profiletracking&utm_medium=sssite&utm_source=ssslideview

Manage Flow using Little’s law
Project Scope End Date
20% 60% 20%
Tool:#4

Limiting Work In Progress
1. Demand
1. Escalation
2. Throttle
2. Service
More tools
1. T-Shape resources
2. SWAT Team
3. Part-time resources
4. Training & Cross-training

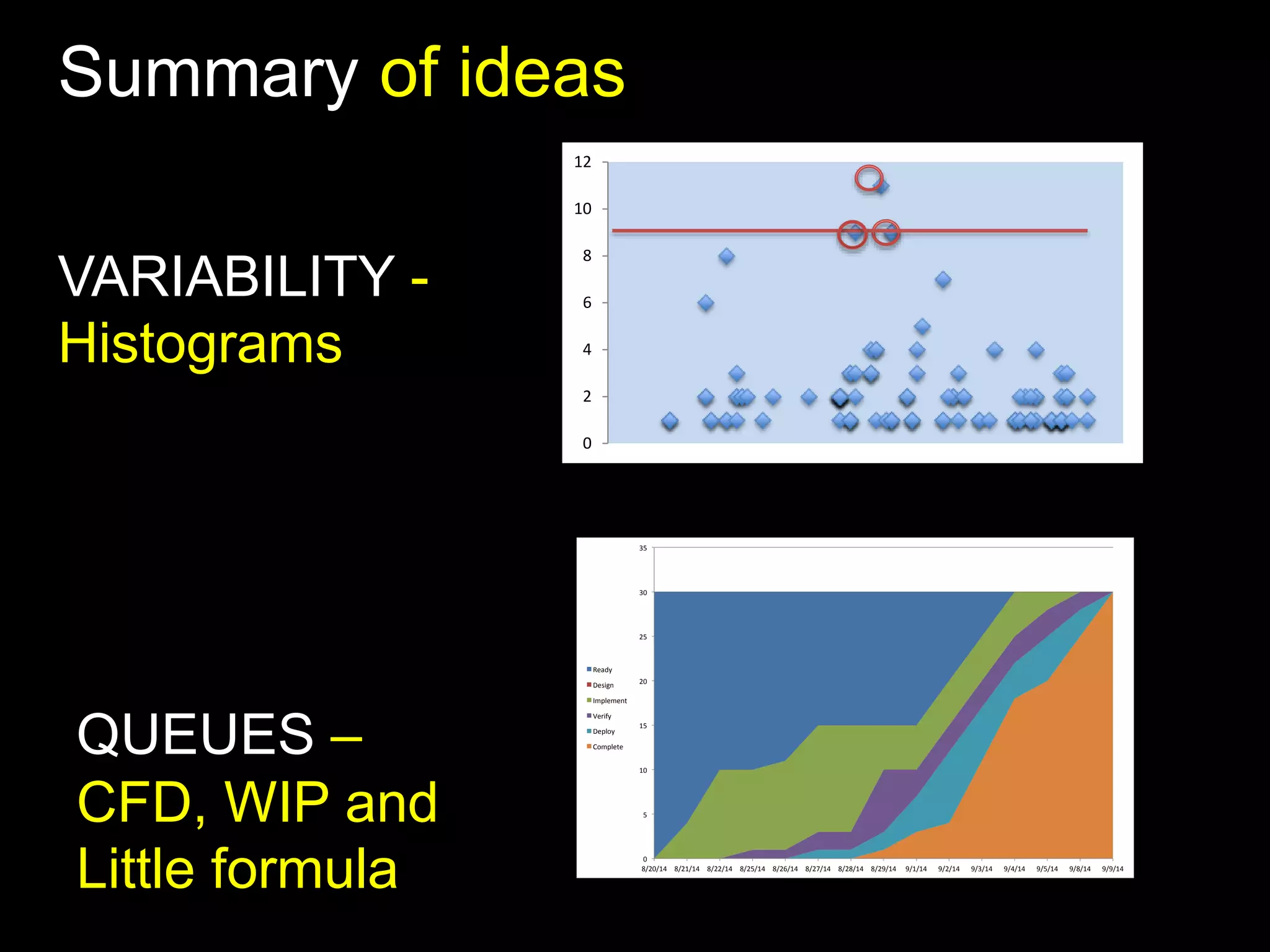

Summary of ideas
Cycle Time
12
10
8
6
4
2
0
VARIABILITY -
Histograms
35
30
25
20
QUEUES –
15
10
CFD, WIP and
5
Little formula 0
8/20/14	 8/21/14	 8/22/14	 8/25/14	 8/26/14	 8/27/14	 8/28/14	 8/29/14	 9/1/14	 9/2/14	 9/3/14	 9/4/14	 9/5/14	 9/8/14	 9/9/14
Ready
Design
Implement
Verify
Deploy
Complete
Research more reading these books
More about me
Pablo Domingo
@pavleras
Becomingagile.wordpress.com

Flow Product Development

  • 1.
    Flow Product Development Pablo Domingo @pavleras
  • 2.
    Principles Variability Queues& Resource Efficiency
  • 3.
  • 4.
  • 5.
    Principle #1: Deliverfast Backlog Develop Ongoing Done Test Deployment Ongoing Done FLOW UNITS
  • 6.
    Principle #1: Deliverfast Backlog Develop Ongoing Done Test Deployment Ongoing Done CONCEPT TO CASH
  • 7.
    Principle #2: Eliminatenon-value added activities. https://www.flickr.com/people/92944716@N05/ Only give me good news
  • 8.
    Principle #2: Eliminatenon-value added activities. https://www.flickr.com/photos/st3f4n/4487662126/
  • 9.
    Principle #2: Eliminatenon-value added activities. 15% 80% Features Value
  • 10.
    Principle #2: Eliminatenon-value added activities.
  • 11.
    Principle #2: Eliminatenon-value added activities. http://www.heraldo.es/galerias-imagenes/chapuzas-en-aragon/#2
  • 12.
    Principle #3: Focuson Flow Units “85% of the reasons for failure to meet customer expectations are relate to deficiencies in systems and processes… rather than the employee”
  • 13.
  • 14.
  • 15.
    Variability – LeanManufacturing You cannot add value without adding variability https://www.flickr.com/photos/urbangarden/
  • 16.
    Variability – ProductDevelopment You cannot add value without adding variability
  • 17.
    Variability – ProductDevelopment You cannot add value without adding variability but you can add variability without adding value Donald Reinertsen
  • 18.
  • 19.
  • 20.
    12 10 CycleTime 8 6 4 2 0 Development time 8/9/14 8/19/14 8/29/14 9/8/14 9/18/14 9/28/14 10/8/14 10/18/14 10/28/14 11/7/14 11/17/14 9-8-2014 – 17/11/2014 #Days UCL= 9 Mean=3,5 LCL=0
  • 21.
    12 10 CycleTime 8 6 4 2 0 Statistical Process Control 8/9/14 8/19/14 8/29/14 9/8/14 9/18/14 9/28/14 10/8/14 10/18/14 10/28/14 11/7/14 11/17/14 9-8-2014 – 17/11/2014 #Days UCL= 9 Mean=3,5 LCL=0 UCL= Mean + 3*Standard Deviation Mean=3,5 LCL= Mean – 3*Standard Deviation
  • 22.
    12 10 CycleTime 8 6 4 2 0 Special Cause Variation 8/9/14 8/19/14 8/29/14 9/8/14 9/18/14 9/28/14 10/8/14 10/18/14 10/28/14 11/7/14 11/17/14 9-8-2014 – 17/11/2014 #Days UCL= 9 Mean=3,5 LCL=0 UCL= Mean + 3*Standard Deviation Mean=3,5 LCL= Mean – 3*Standard Deviation
  • 23.
    Live defects per release 25 20 15 10 5 0 BUGS Lower Control Limit Higher Control Limit Linear (BUGS)
  • 24.

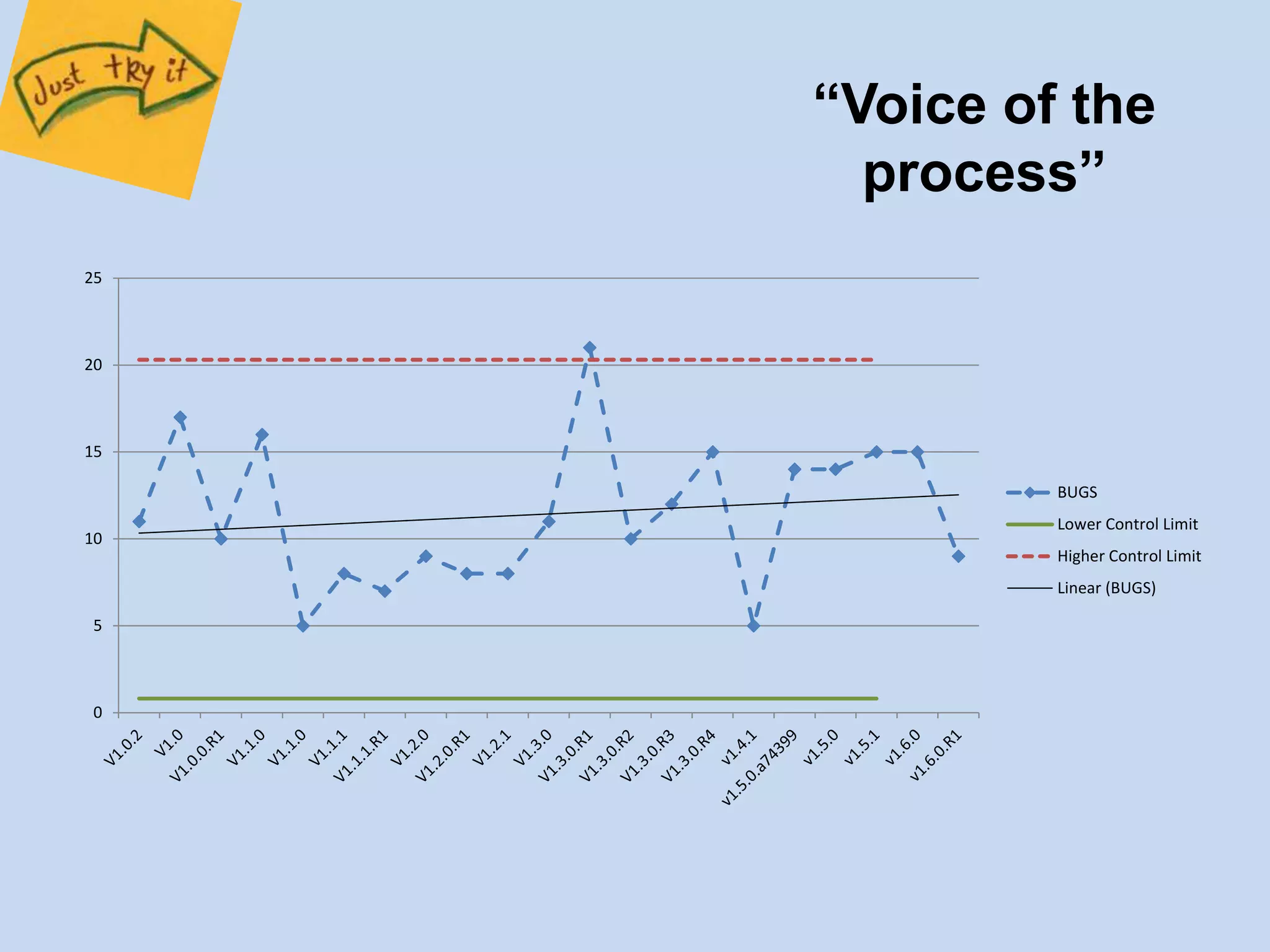

    25 20 15 10 5 0 “Voice of the process” BUGS Lower Control Limit Higher Control Limit Linear (BUGS)
  • 25.
  • 26.
    Flow Product Development Queues & Resource Efficiency
  • 27.
    #2: Queues & Resource Efficiency https://www.flickr.com/photos/donsolo/2332814270/
  • 28.
    Efficiency – Queues Backlog Develop Ongoing Done Test Deployment Ongoing Done Increase Cycle Time Increase Variability & Risk Decrease Efficiency Decrease Quality - Feedback Decrease Motivation
  • 29.
    Efficiency – Queues https://www.flickr.com/photos/wwarby/11682625885/
  • 30.
    Efficiency – QueuingTheory Queues + Variability + Resource efficiency? https://www.flickr.com/photos/skycaptaintwo/
  • 31.
    Efficiency – QueuingTheory Non-linear Exponential
  • 32.
    Small changes incapacity utilization… 4 times Cycle time
  • 33.
  • 34.
  • 35.
    Backlog Develop OngoingDone Test Deployment Ongoing Done 6 5 4 3 2 1 0 12/8/14 12/8/14 Ready To Do In progress Test Deploy Complete
  • 36.
    Backlog Develop OngoingDone Test Deployment Ongoing Done 6 5 4 3 2 1 0 12/8/14 12/9/14 Ready To Do In progress Test Deploy Complete
  • 37.
    Backlog Develop OngoingDone Test Deployment Ongoing Done 6 5 4 3 2 1 0 12/8/14 12/9/14 12/10/14 12/11/14 12/12/14 Ready To Do In progress Test Deploy Complete
  • 38.
    Backlog Develop OngoingDone Test Deployment Ongoing Done 6 5 4 3 2 1 0 12/8/14 12/9/14 12/10/14 12/11/14 12/12/14 12/13/14 Ready To Do In progress Test Deploy Complete
  • 39.
    Backlog Develop OngoingDone Test Deployment Ongoing Done 6 5 4 3 2 1 0 12/8/14 12/9/14 12/10/14 12/11/14 12/12/14 12/13/14 12/14/14 Ready To Do In progress Test Deploy Complete
  • 40.
    Backlog Develop OngoingDone Test Deployment Ongoing Done 6 5 4 3 2 1 0 12/8/14 12/9/14 12/10/14 12/11/14 12/12/14 12/13/14 12/14/14 12/15/14 Ready To Do In progress Test Deploy Complete
  • 41.
    35 30 25 20 15 10 5 0 8/20/14 8/21/14 8/22/14 8/25/14 8/26/14 8/27/14 8/28/14 8/29/14 9/1/14 9/2/14 9/3/14 9/4/14 9/5/14 9/8/14 9/9/14 Ready Design Implement Verify Deploy Complete CYCLE TIME
  • 42.
    35 30 25 20 15 10 5 0 8/20/14 8/21/14 8/22/14 8/25/14 8/26/14 8/27/14 8/28/14 8/29/14 9/1/14 9/2/14 9/3/14 9/4/14 9/5/14 9/8/14 9/9/14 Ready Design Implement Verify Deploy Complete LEAD TIME
  • 43.
    35 30 25 20 15 10 5 0 8/20/14 8/21/14 8/22/14 8/25/14 8/26/14 8/27/14 8/28/14 8/29/14 9/1/14 9/2/14 9/3/14 9/4/14 9/5/14 9/8/14 9/9/14 Ready Design Implement Verify Deploy Complete Limiting WIP? QUANTITY IN QUEUE
  • 44.
    35 30 25 20 15 10 5 0 8/20/14 8/21/14 8/22/14 8/25/14 8/26/14 8/27/14 8/28/14 8/29/14 9/1/14 9/2/14 9/3/14 9/4/14 9/5/14 9/8/14 9/9/14 Ready Design Implement Verify Deploy Complete QUANTITY IN QUEUE WIP Constraint
  • 45.
    35 30 25 20 15 10 5 0 8/20/14 8/21/14 8/22/14 8/25/14 8/26/14 8/27/14 8/28/14 8/29/14 9/1/14 9/2/14 9/3/14 9/4/14 9/5/14 9/8/14 9/9/14 Ready Design Implement Verify Deploy Complete QUANTITY IN QUEUE WIP Constraint
  • 46.
    35 30 25 20 15 10 5 0 PREVIOUS CYCLE TIME VS NEW CYCLE TIME 8/20/14 8/21/14 8/22/14 8/25/14 8/26/14 8/27/14 8/28/14 8/29/14 9/1/14 9/2/14 9/3/14 9/4/14 9/5/14 9/8/14 9/9/14 Ready Design Implement Verify Deploy Complete QUANTITY IN QUEUE WIP Constraint
  • 47.
  • 48.
    Manage Flow usingLittle’s law Throughput = WIP Lead Time http://www.slideshare.net/wwiedenroth?utm_campaign=profiletracking&utm_medium=sssite&utm_source=ssslideview
  • 49.
    Manage Flow usingLittle’s law Calculate Project Lead Time Project Lead Time = N. of Flow Units Average Lead Time Average WIP = 500 10 days 8 items = 125 weeks http://www.slideshare.net/wwiedenroth?utm_campaign=profiletracking&utm_medium=sssite&utm_source=ssslideview
  • 50.
    Manage Flow usingLittle’s law Project Scope End Date 20% 60% 20%
  • 51.
  • 53.
    1. Demand 1.Escalation 2. Throttle 2. Service More tools 1. T-Shape resources 2. SWAT Team 3. Part-time resources 4. Training & Cross-training
  • 54.
    Summary of ideas Cycle Time 12 10 8 6 4 2 0 VARIABILITY - Histograms 35 30 25 20 QUEUES – 15 10 CFD, WIP and 5 Little formula 0 8/20/14 8/21/14 8/22/14 8/25/14 8/26/14 8/27/14 8/28/14 8/29/14 9/1/14 9/2/14 9/3/14 9/4/14 9/5/14 9/8/14 9/9/14 Ready Design Implement Verify Deploy Complete
  • 55.
  • 56.
    More about me Pablo Domingo @pavleras Becomingagile.wordpress.com

Editor's Notes

  • #5  ----- Meeting Notes (26/11/14 14:55) ----- DESPACIO
  • #6  ----- Meeting Notes (26/11/14 14:55) ----- Innovation Competitive advantage Reducing cycle time
  • #9 ARBITRARY deadlines SPECIALIST bottlenecks OVERTIME
  • #10 ARBITRARY deadlines SPECIALIST bottlenecks OVERTIME
  • #11  ----- Meeting Notes (26/11/14 14:55) ----- feature creep
  • #13  ----- Meeting Notes (26/11/14 14:55) ----- REWORK
  • #20  ----- Meeting Notes (26/11/14 15:05) ----- monitorize system's events
  • #21  ----- Meeting Notes (26/11/14 15:05) ----- horizontal = tiempo vertical = variable
  • #23  ----- Meeting Notes (26/11/14 15:05) ----- Determine if process is in Statistical Process Control
  • #24  ----- Meeting Notes (26/11/14 15:05) ----- Continuous improvement
