Lead Time:
What We Know About It
And How It Can Help Forecast Your Projects
Alexei Zheglov
Agile DC
Washington, October 2014
Alexei Zheglov
connected-knowledge.
com
alex@LeanAtoZ.com
@az1
#agiledc
Goodhart’s Law
“When a measure becomes a target,
it ceases to be a good measure.”

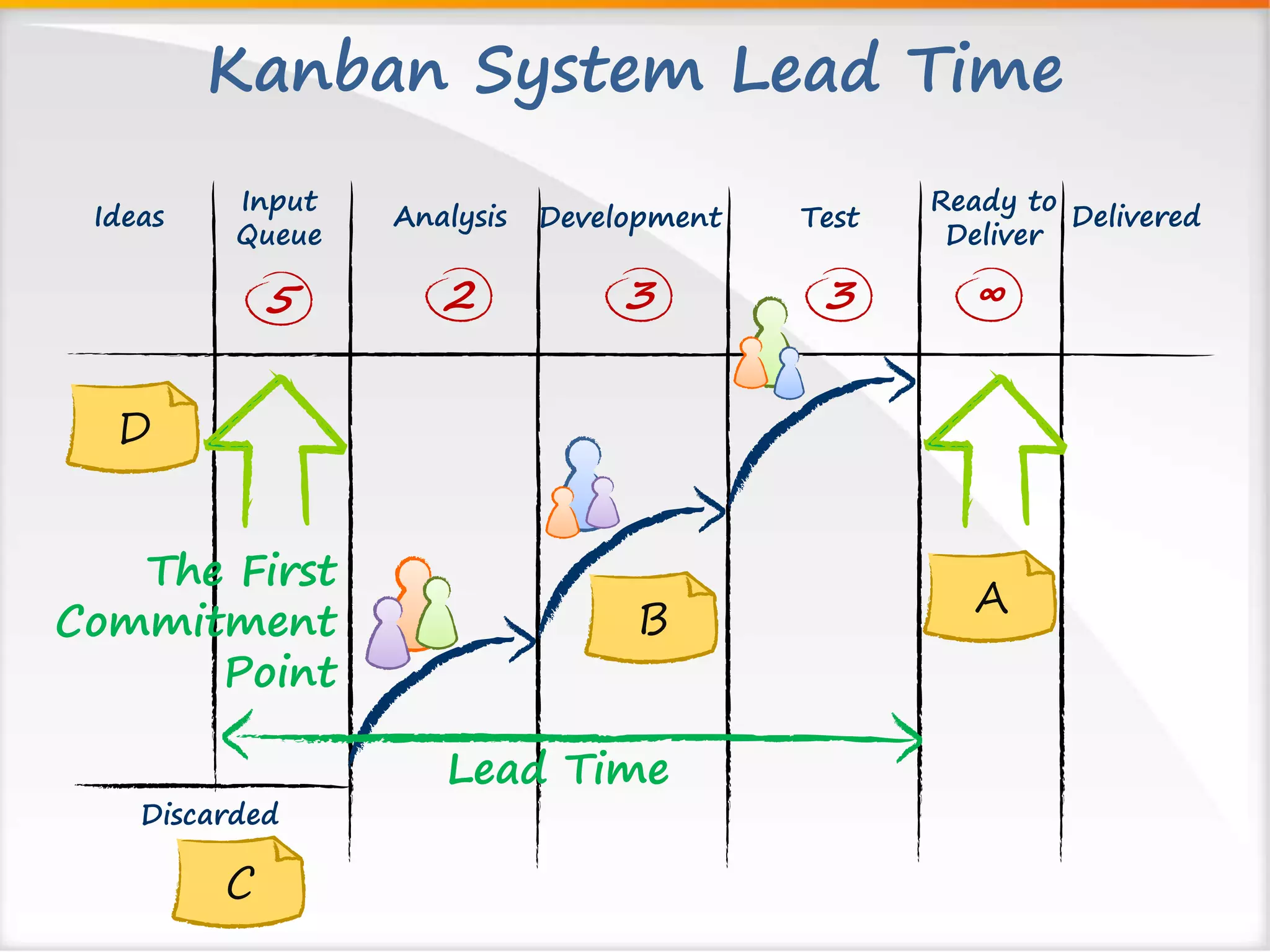

Kanban System Lead Time
Ideas Input Analysis Delivered
Queue
Ready to
Deliver
Development Test
5 2 3
3 ∞
Lead Time
The First
Commitment
Point
B A
Discarded
C
D

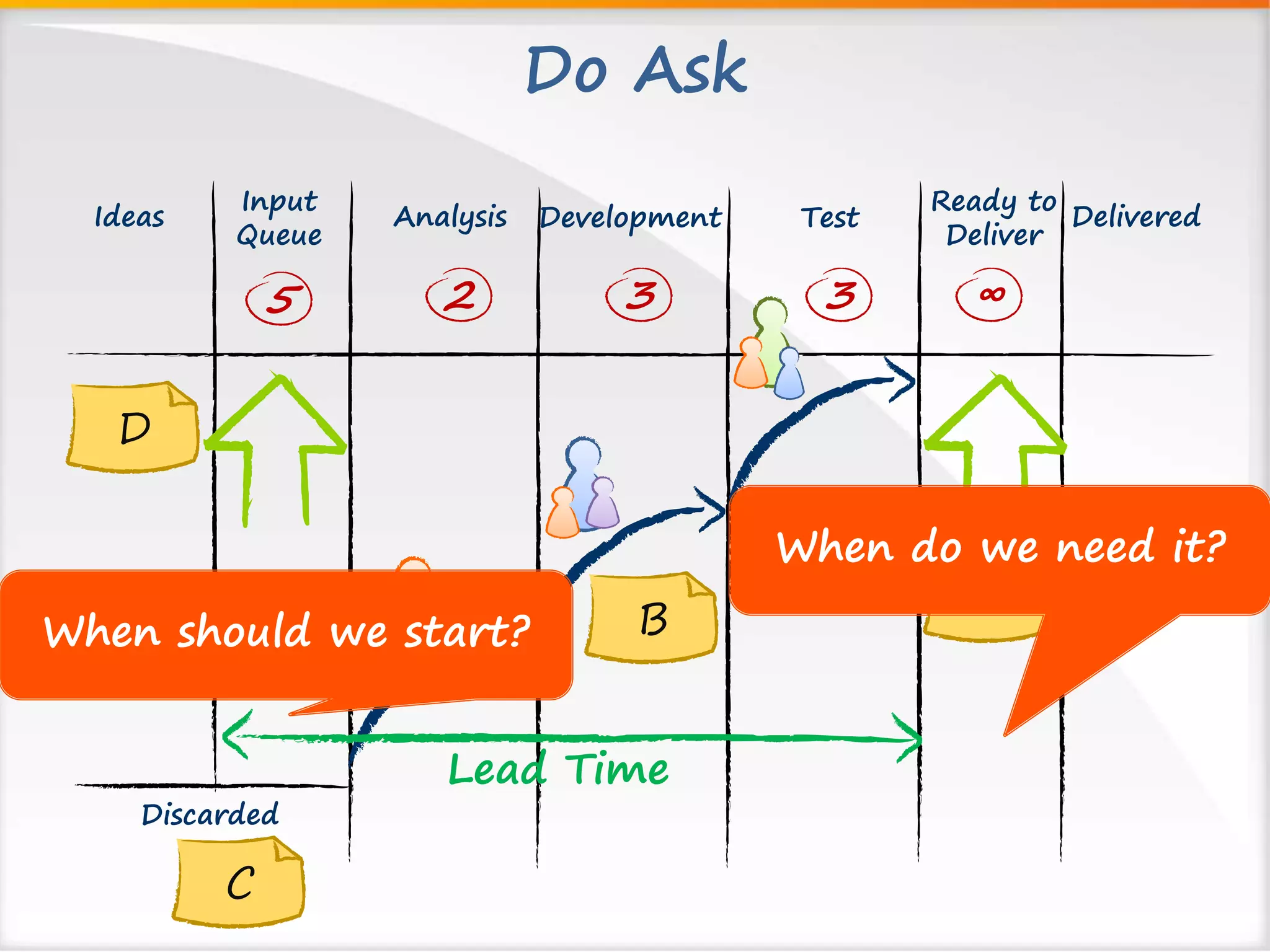

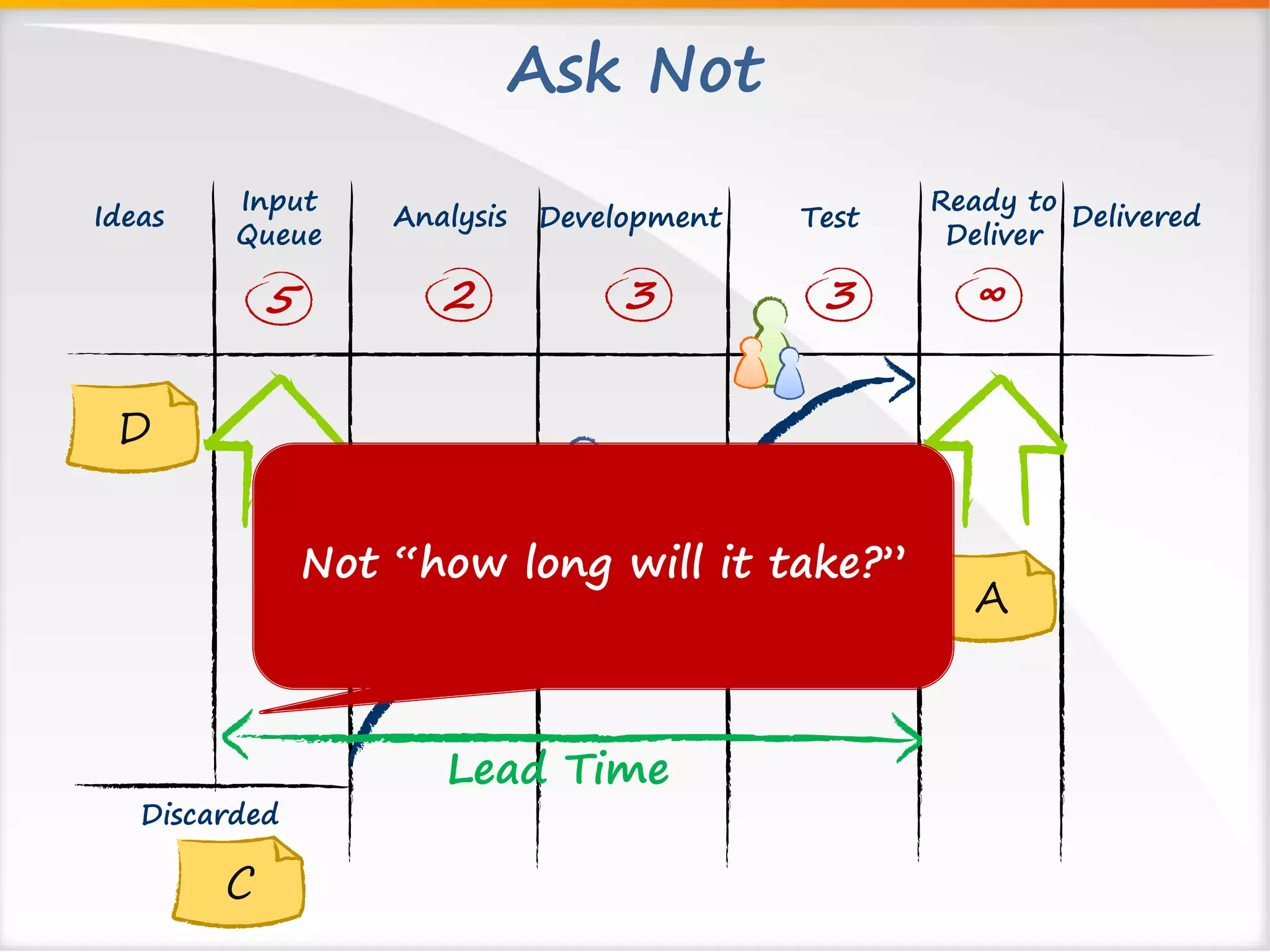

Ask Not
Ideas Input Analysis Delivered
Queue
Ready to
Deliver
Development Test
5 2 3
3 ∞
B A
Lead Time
Discarded
C
D
Not “how long will it take?”
Do Ask
Ideas Input Analysis Delivered
Queue
Ready to
Deliver
Development Test
5 2 3
3 ∞
B A
Lead Time
Discarded
C
D
When should we start?
When do we need it?

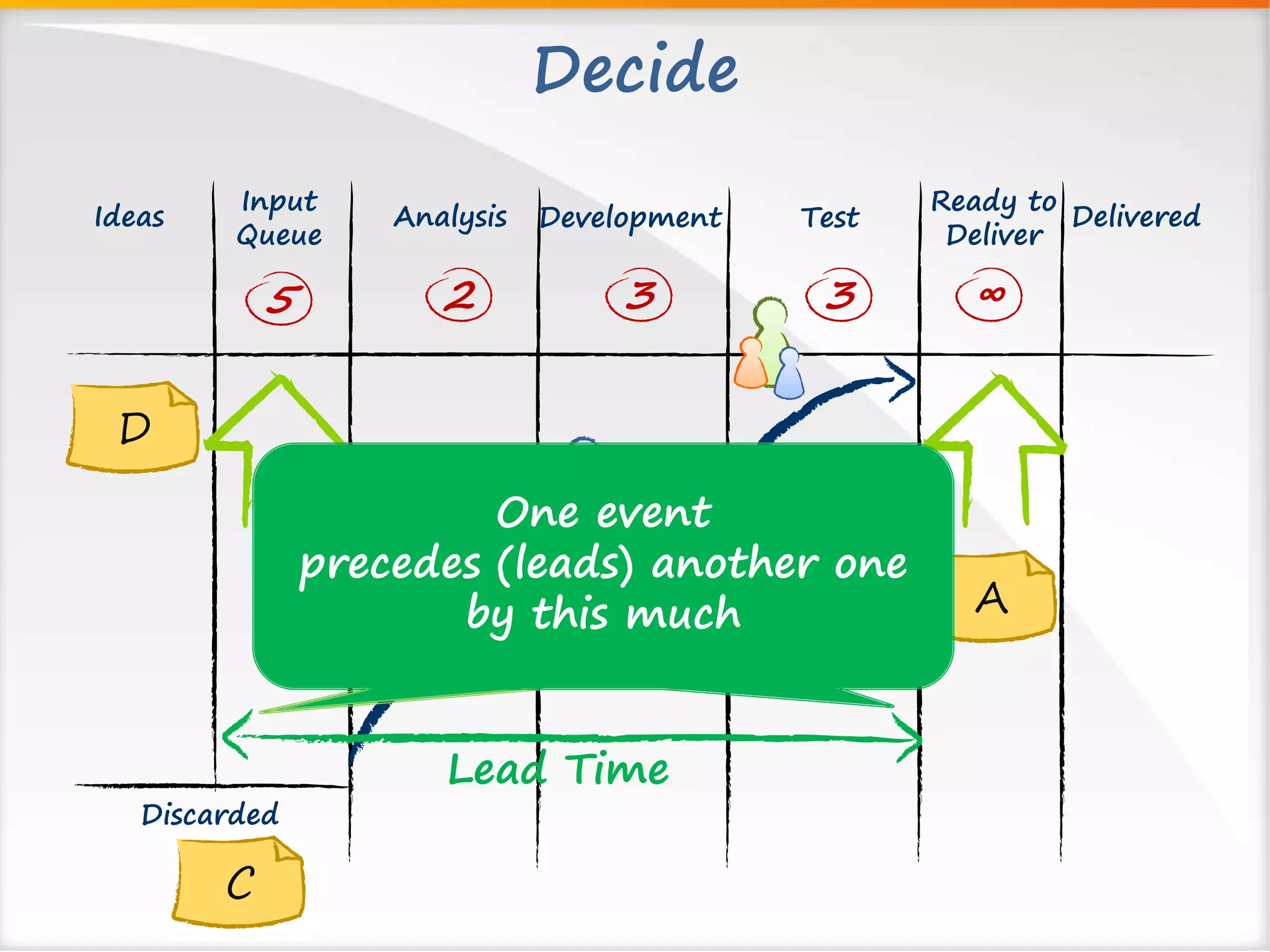

Decide
Ideas Input Analysis Delivered
Queue
Ready to
Deliver
Development Test
5 2 3
3 ∞
B A
Lead Time
Discarded
C
D
One event
precedes (leads) another one
by this much
Why?
Ideas Input Analysis Delivered
Queue
Ready to
Deliver
Development Test
5 2 3
3 ∞
Lead Time
The First
Commitment
Point
B A
Discarded
C
D

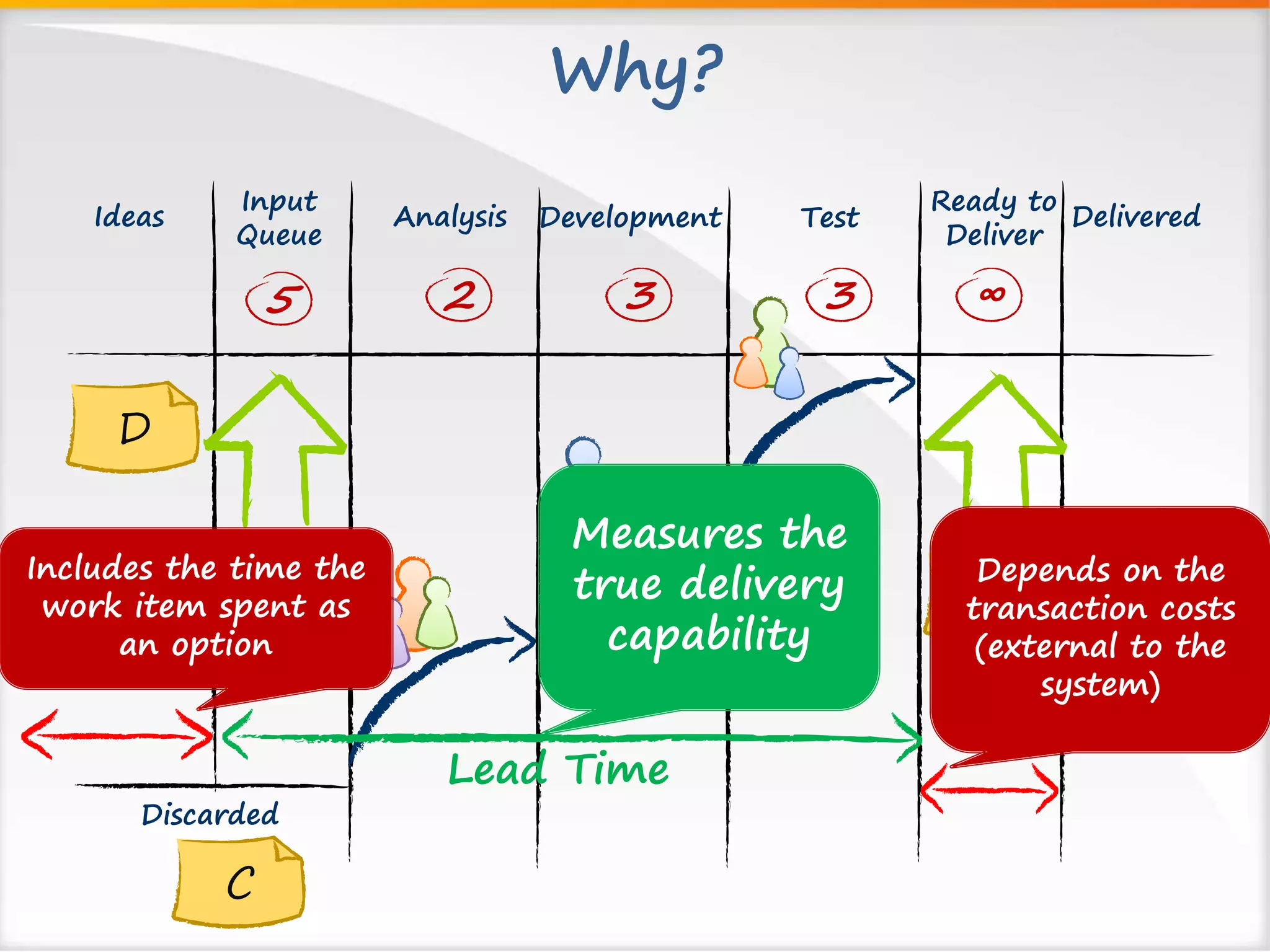

Includes the time the
work item spent as
an option
Depends on the
transaction costs
(external to the
system)
Measures the
true delivery
capability

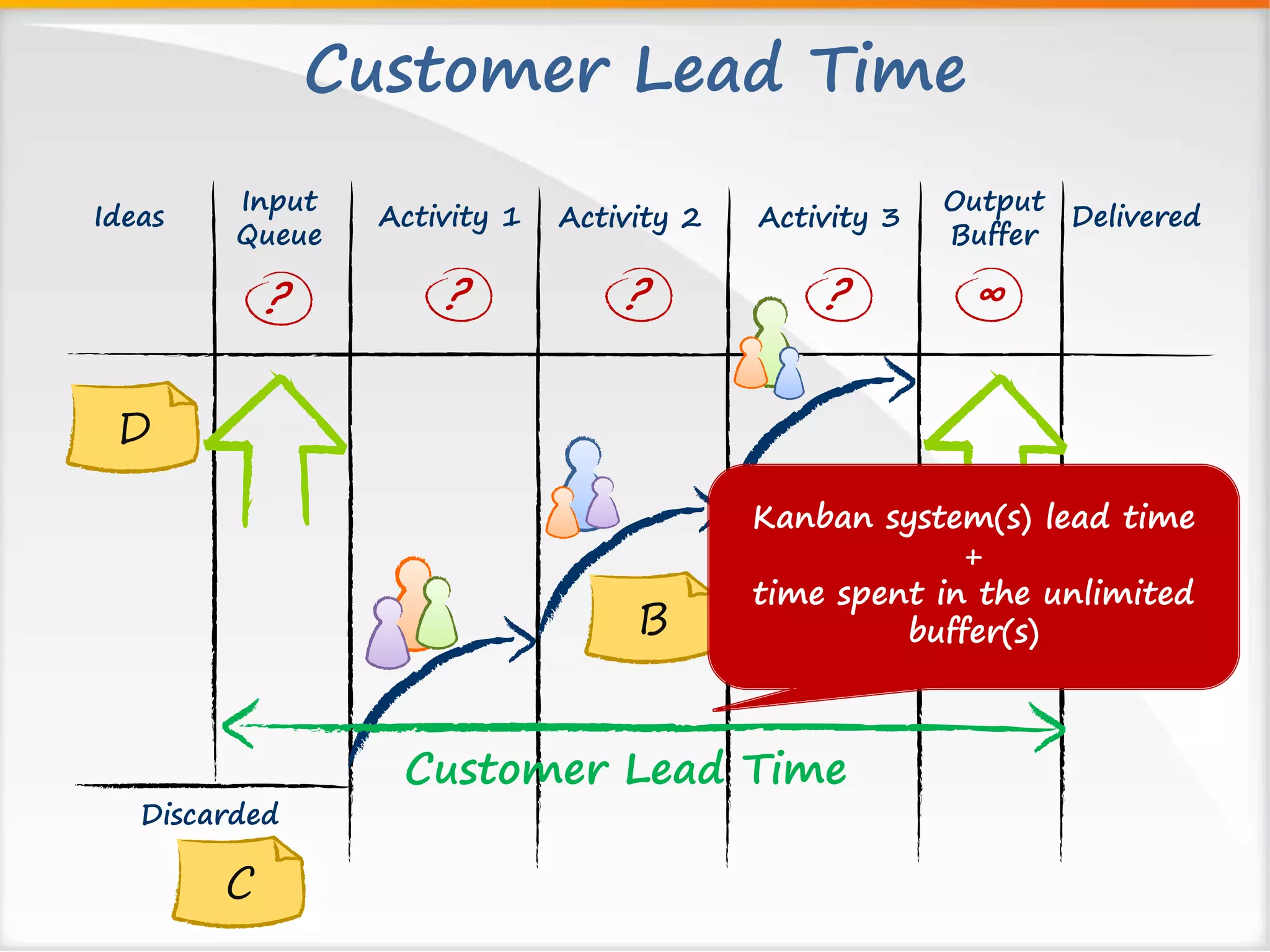

Customer Lead Time
Ideas Input Activity 1 Delivered
Queue
Output
Buffer
Activity 2 Activity 3
? ? ?
? ∞
Kanban system(s) lead time
B A
Customer Lead Time
+
time spent in the unlimited
buffer(s)
Discarded
C
D

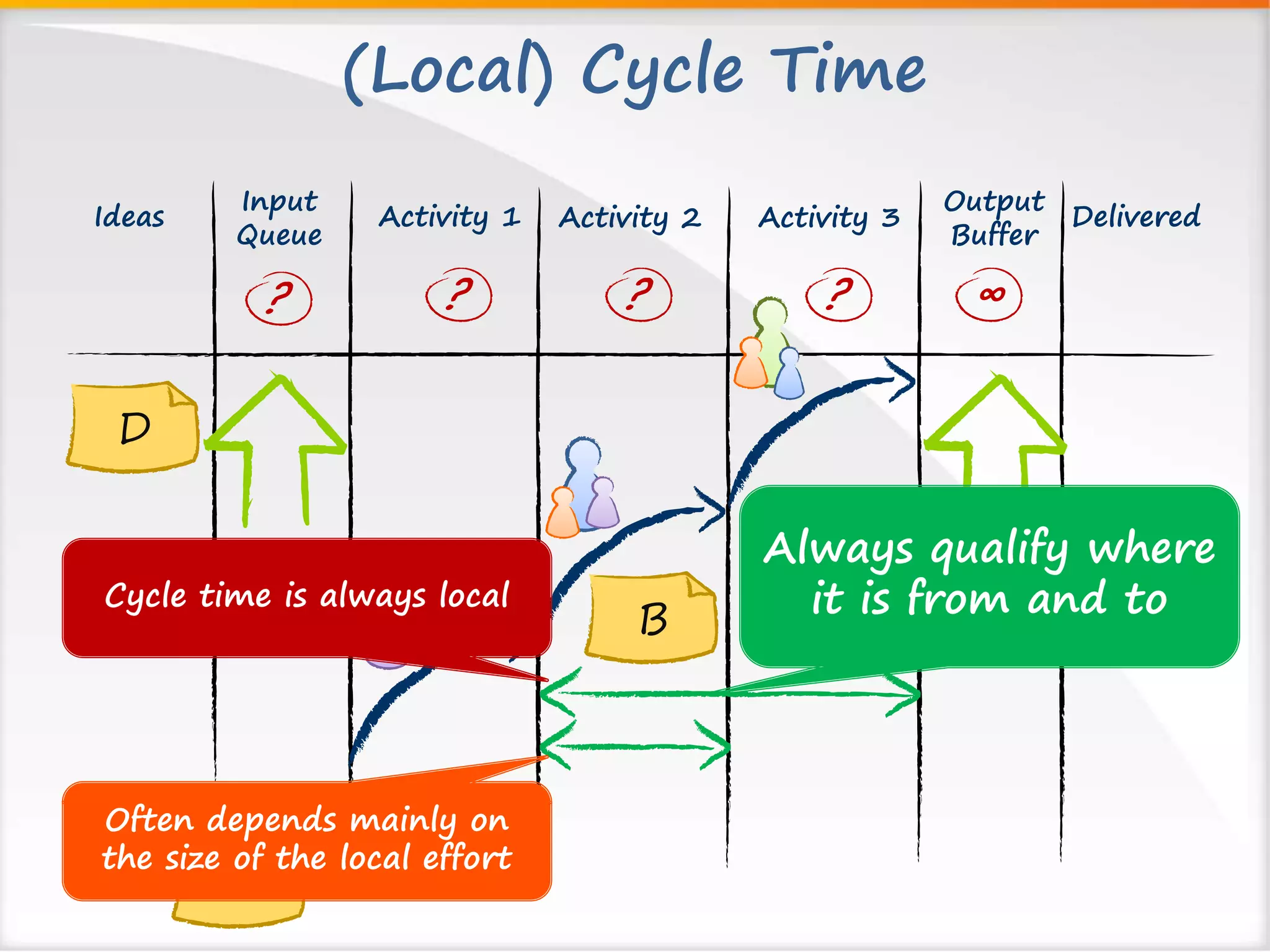

(Local) Cycle Time
Ideas Input Activity 1 Delivered
Queue
Output
Buffer
Activity 2 Activity 3
? ? ?
? ∞
B A
Discarded
C
D
Cycle time is always local
Always qualify where
it is from and to
Often depends mainly on
the size of the local effort

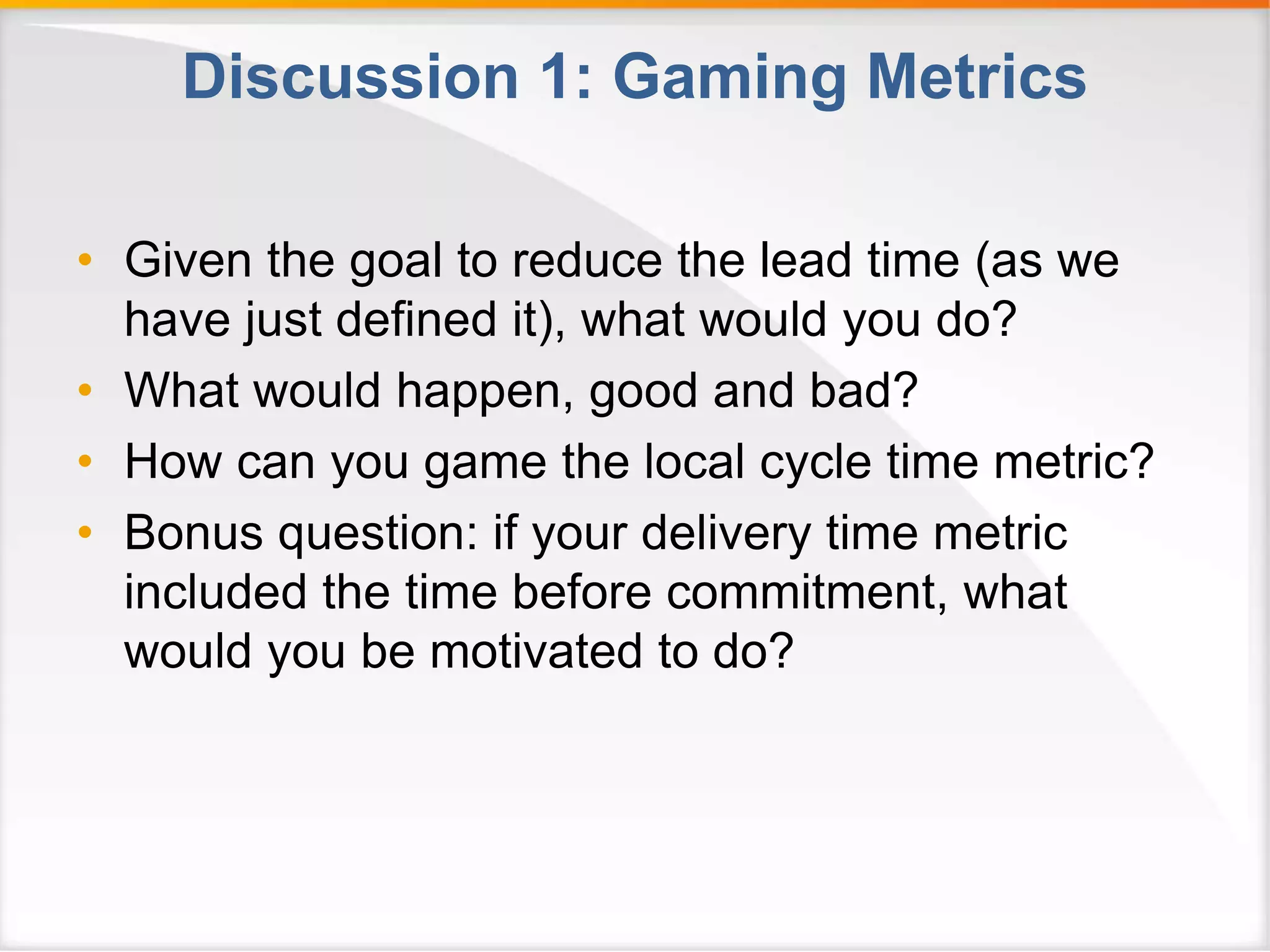

Discussion 1: Gaming Metrics
• Given the goal to reduce the lead time (as we
have just defined it), what would you do?
• What would happen, good and bad?
• How can you game the local cycle time metric?
• Bonus question: if your delivery time metric
included the time before commitment, what
would you be motivated to do?

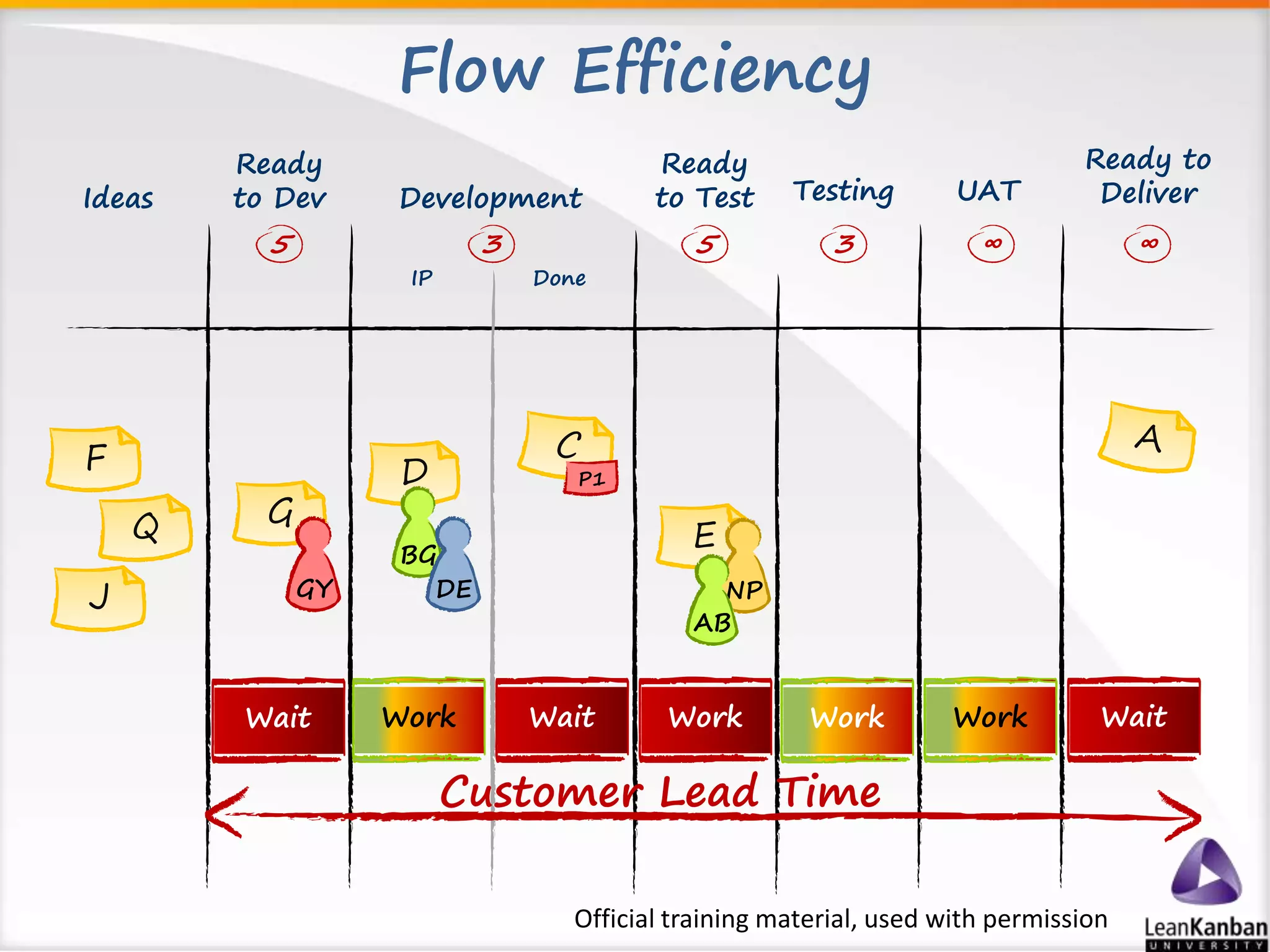

Flow Efficiency
Ready
to Test
F
Development Testing
3 5 3
E
J
G
D
GY
BG
P1
DE NP
AB
Wait Work Wait Work
Customer Lead Time
Ideas
Ready
to Dev
5
IP
Done
UAT
Ready to
Deliver
∞ ∞
Work Work Wait
Official training material, used with permission
Flow Efficiency
Ready
to Test
F
Development Testing
3 5 3
E
J
G
D
GY
BG
P1
DE NP
AB
Wait Work Wait Work
Customer Lead Time
Ideas
Ready
to Dev
5
IP
Done
UAT
Ready to
Deliver
∞ ∞
Work Work Wait
Official training material, used with permission

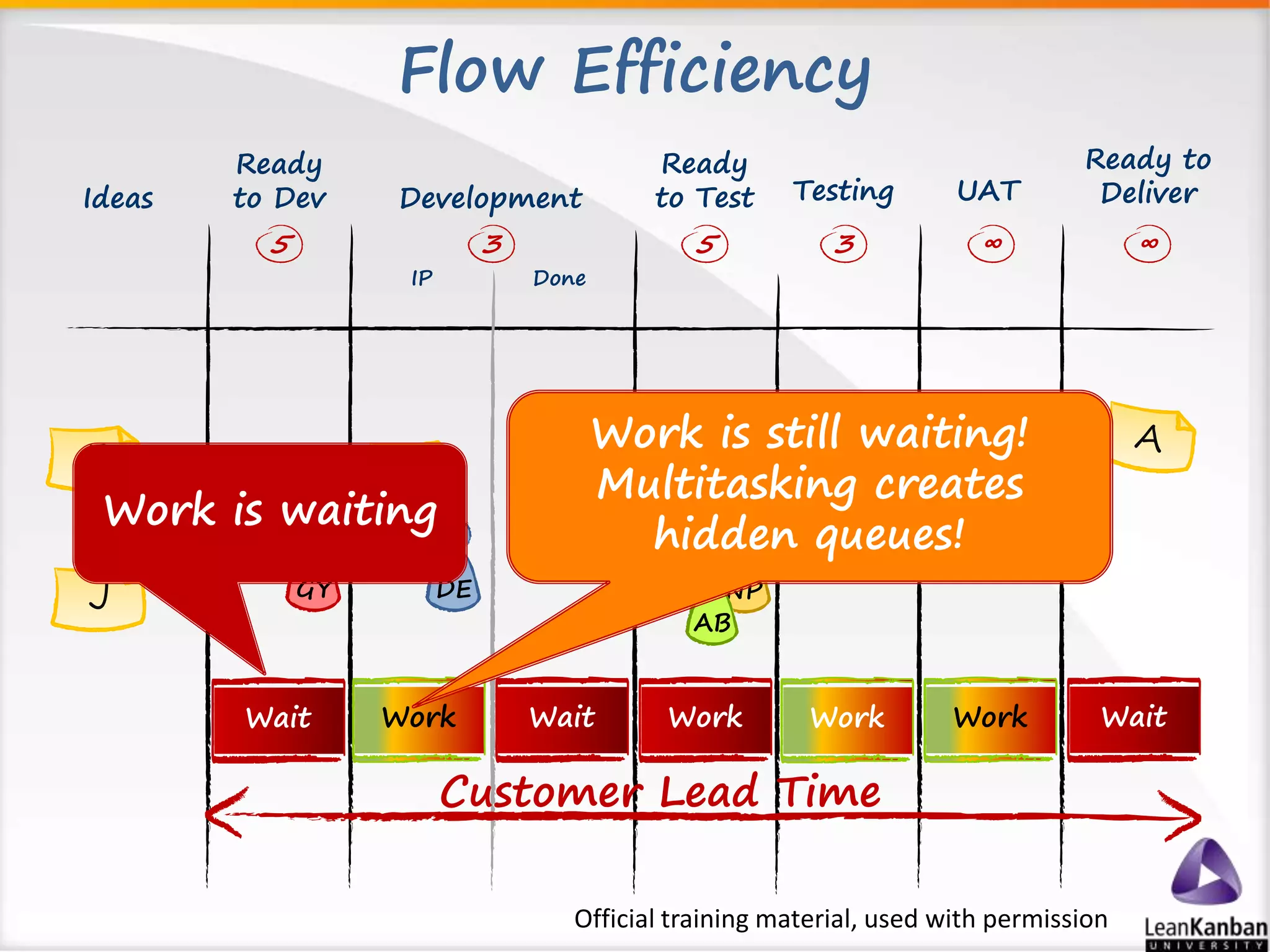

Work is waiting
Work is still waiting!
Multitasking creates
hidden queues!

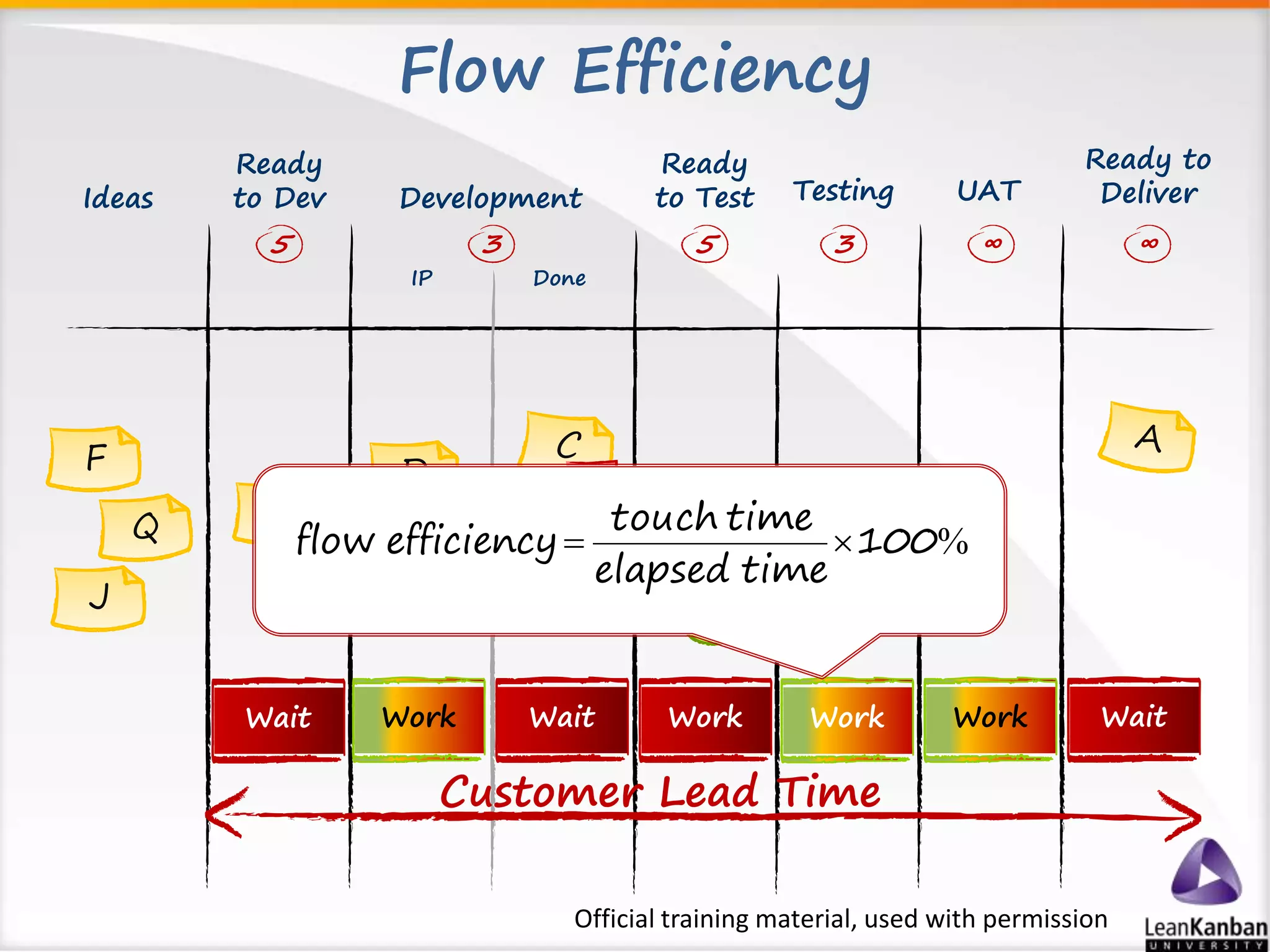

Flow Efficiency
Ready
to Test
F
Development Testing
3 5 3
touch time
E
J
G
D
flow efficiency  
GY
BG
P1
elapsed time
DE NP
AB
Wait Work Wait Work
100%
Customer Lead Time
Ideas
Ready
to Dev
5
IP
Done
UAT
Ready to
Deliver
∞ ∞
Work Work Wait
Official training material, used with permission

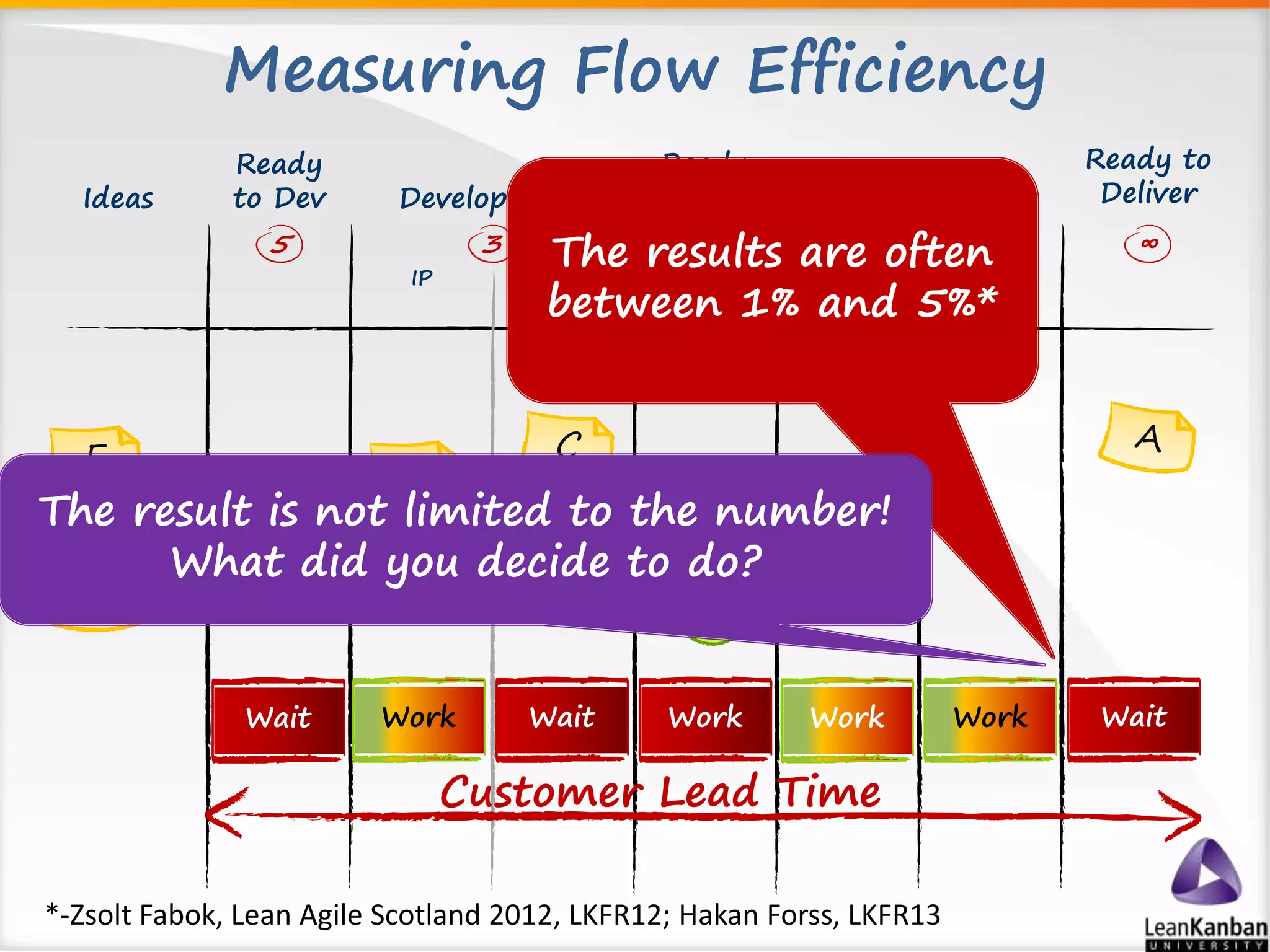

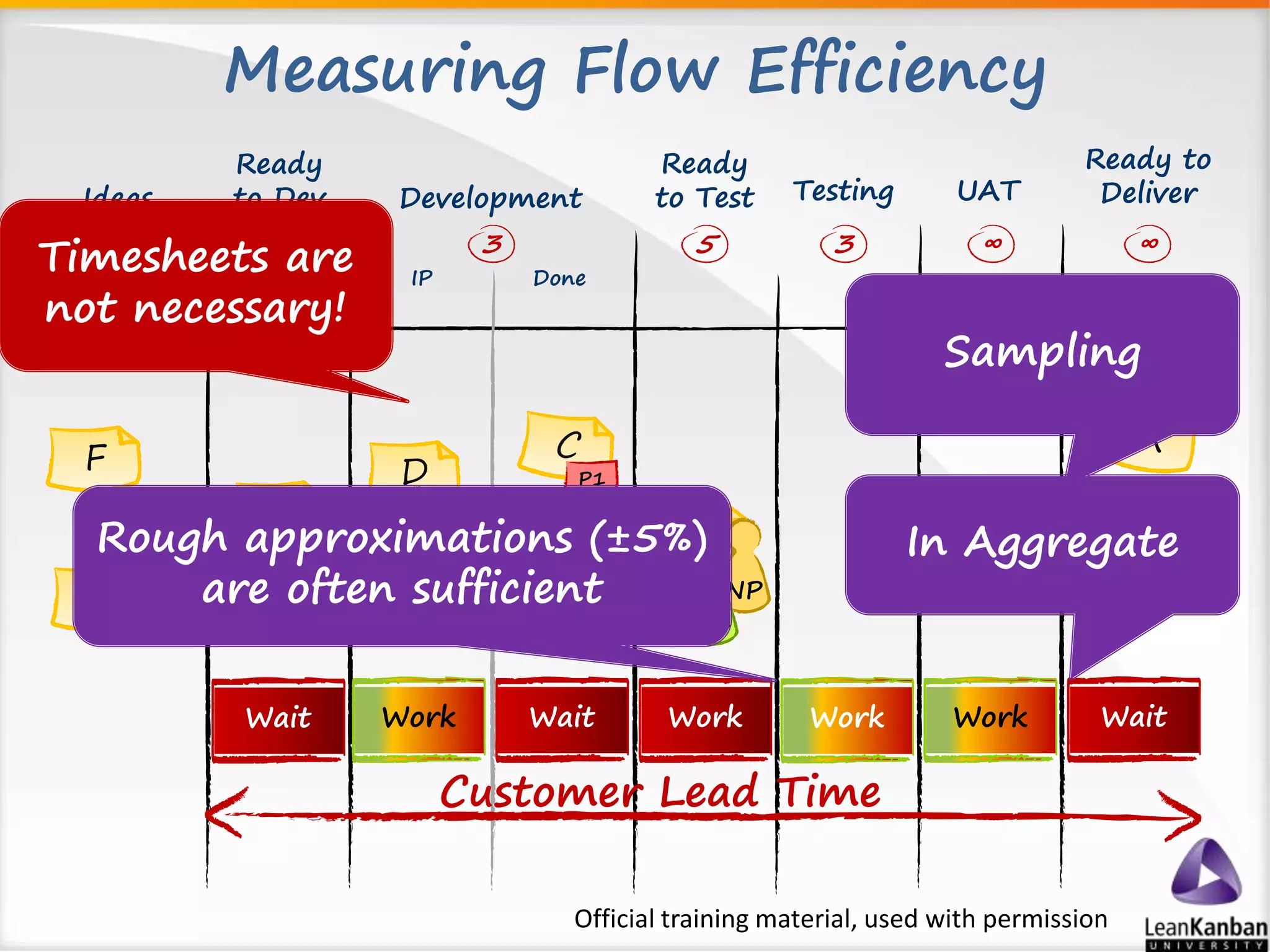

Measuring Flow Efficiency
Ready
to Test
F
Development Testing
3 5 3
E
J
G
D
GY
BG
P1
DE NP
AB
Wait Work Wait Work
Customer Lead Time
Ideas
Ready
to Dev
5
IP
Done
UAT
Ready to
Deliver
∞ ∞
Sampling
Work Work Wait
Official training material, used with permission
Timesheets are
not necessary!
Rough approximations (±5%)
are often sufficient
In Aggregate
Measuring Flow Efficiency
Ready
to Test
F
Development Testing
3 5 3
The results are often
between 1% and 5%*
The result is not limited to the number!
E
J
G
D
What did you decide to do?
GY
BG
P1
DE NP
AB
Wait Work Wait Work
Customer Lead Time
Ideas
Ready
to Dev
5
IP
Done
UAT
Ready to
Deliver
∞ ∞
Work Work Wait
*-Zsolt Fabok, Lean Agile Scotland 2012, LKFR12; Hakan Forss, LKFR13

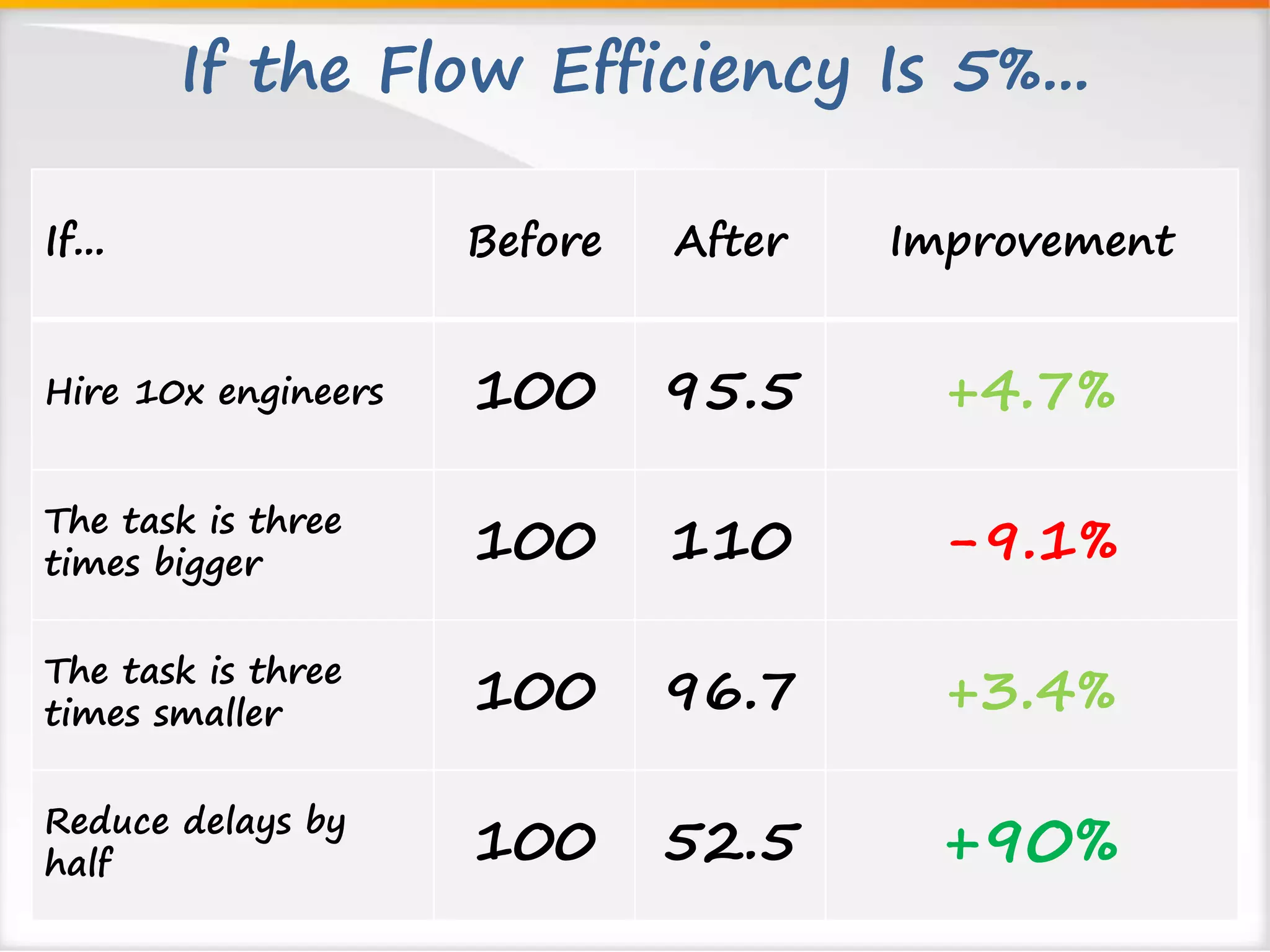

If the Flow Efficiency Is 5%...
If... Before After Improvement
Hire 10x engineers 100 95.5 +4.7%
The task is three
times bigger 100 110 -9.1%
The task is three
times smaller 100 96.7 +3.4%
Reduce delays by
half 100 52.5 +90%

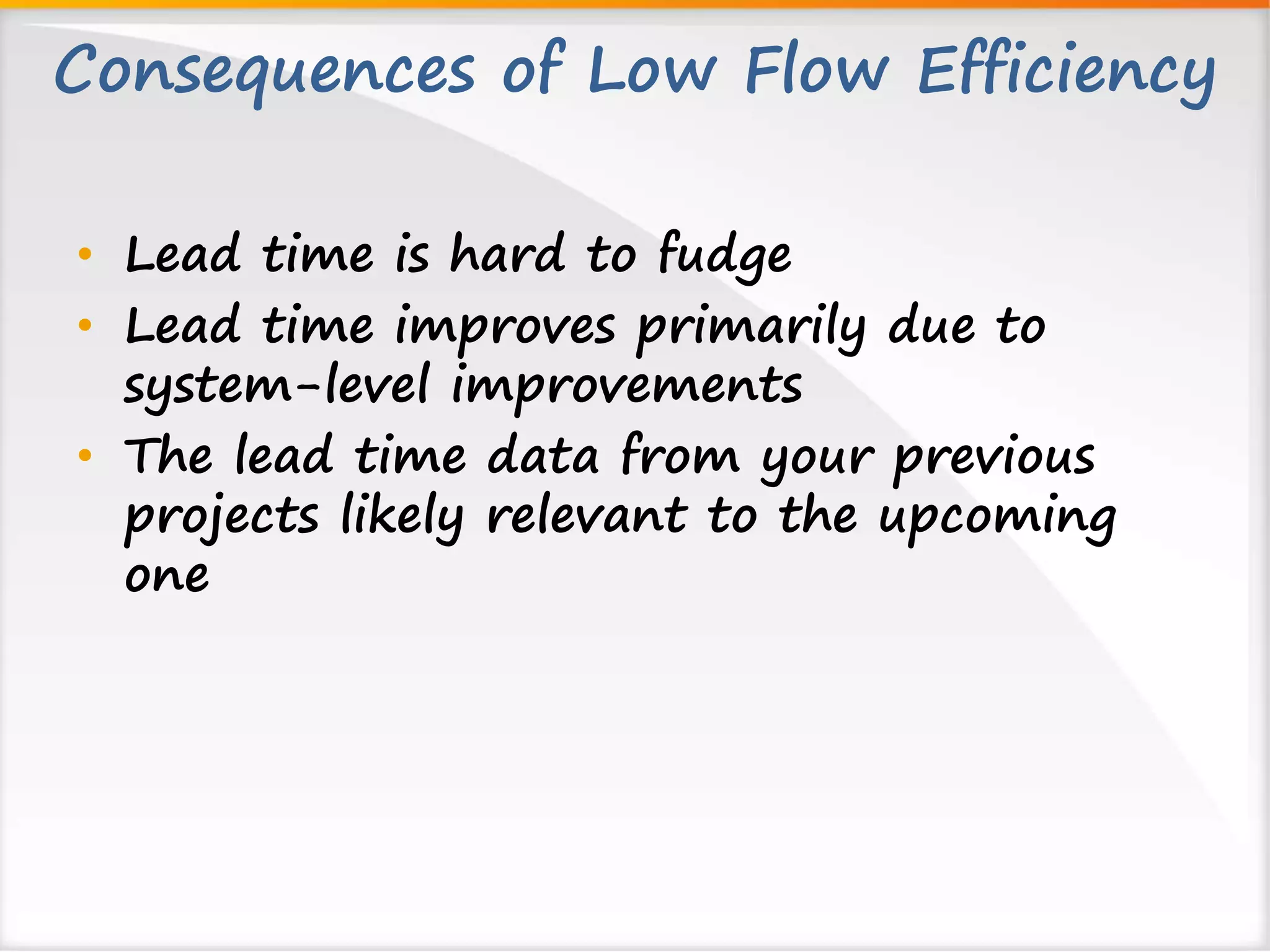

Consequences of Low Flow Efficiency
• Lead time is hard to fudge
• Lead time improves primarily due to
system-level improvements
• The lead time data from your previous
projects likely relevant to the upcoming
one
Goodhart’s Law’s
Corollary
Measuring the delivery time
cannot be separated from
understanding commitment.
Start Measuring?

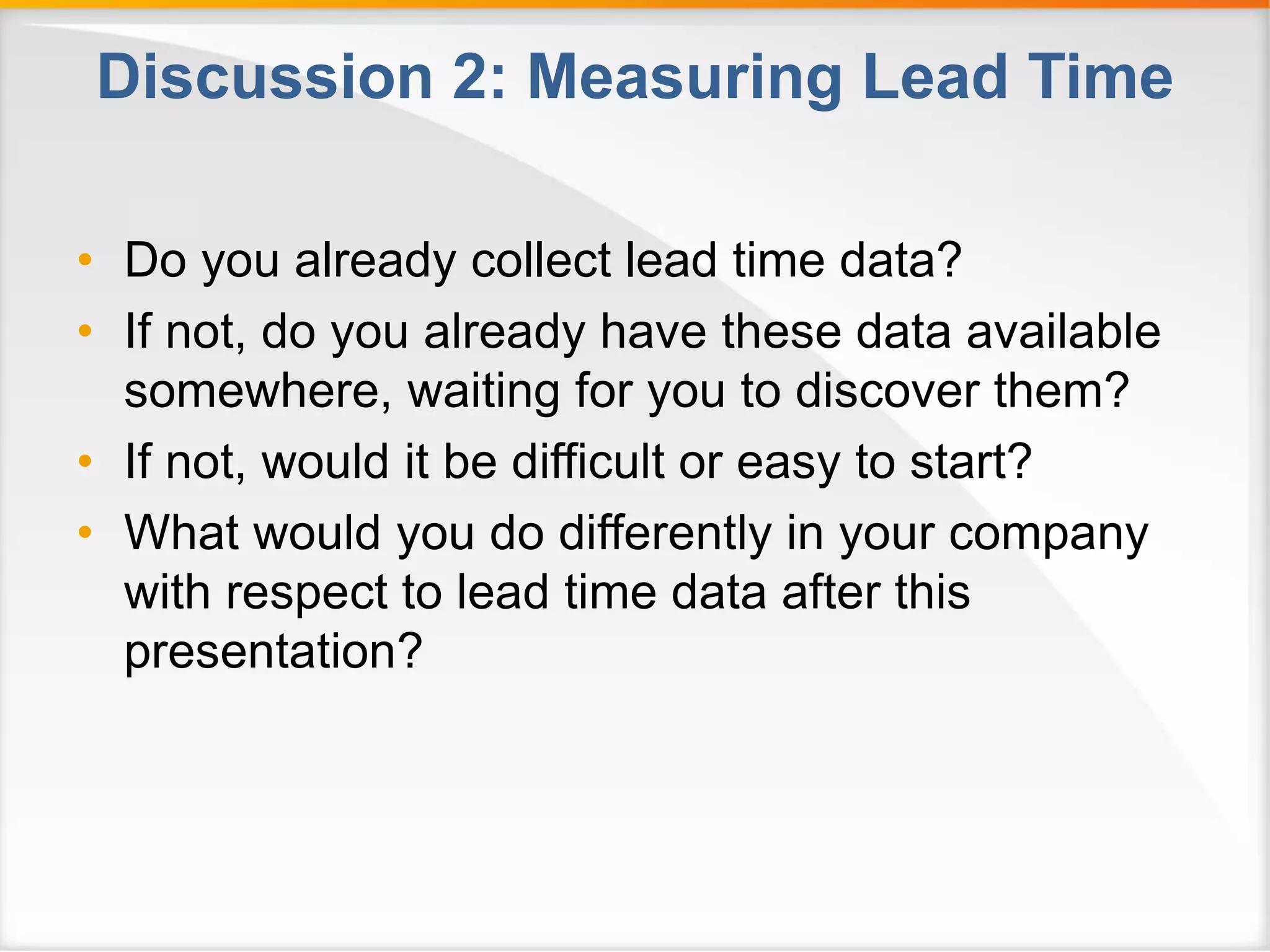

Discussion 2: Measuring Lead Time
• Do you already collect lead time data?
• If not, do you already have these data available
somewhere, waiting for you to discover them?
• If not, would it be difficult or easy to start?
• What would you do differently in your company
with respect to lead time data after this
presentation?
probabilistic
Deterministic approach
to a probabilistic process?
!!!
20
18
16
14
12
10
8
6
4
2
0

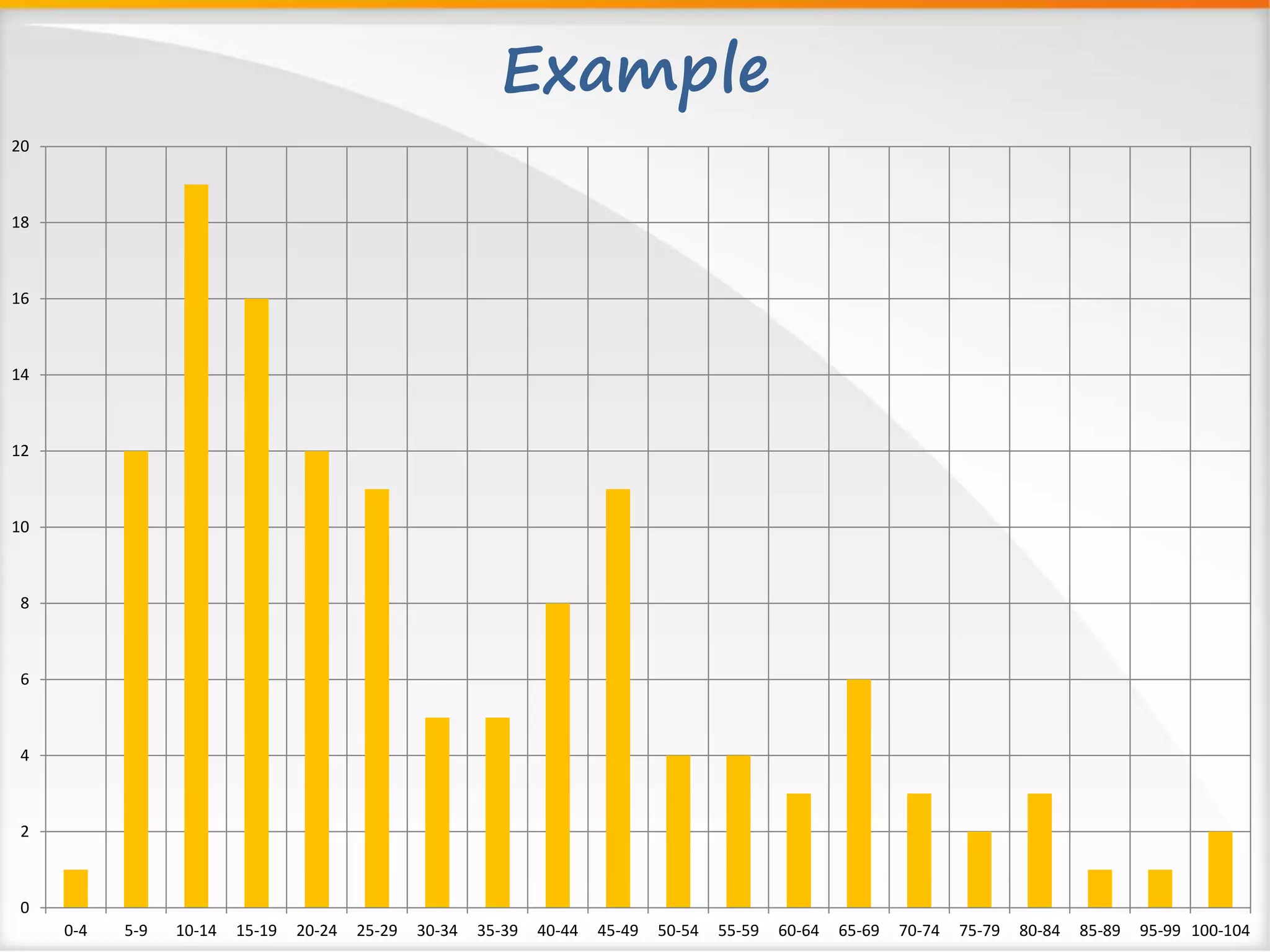

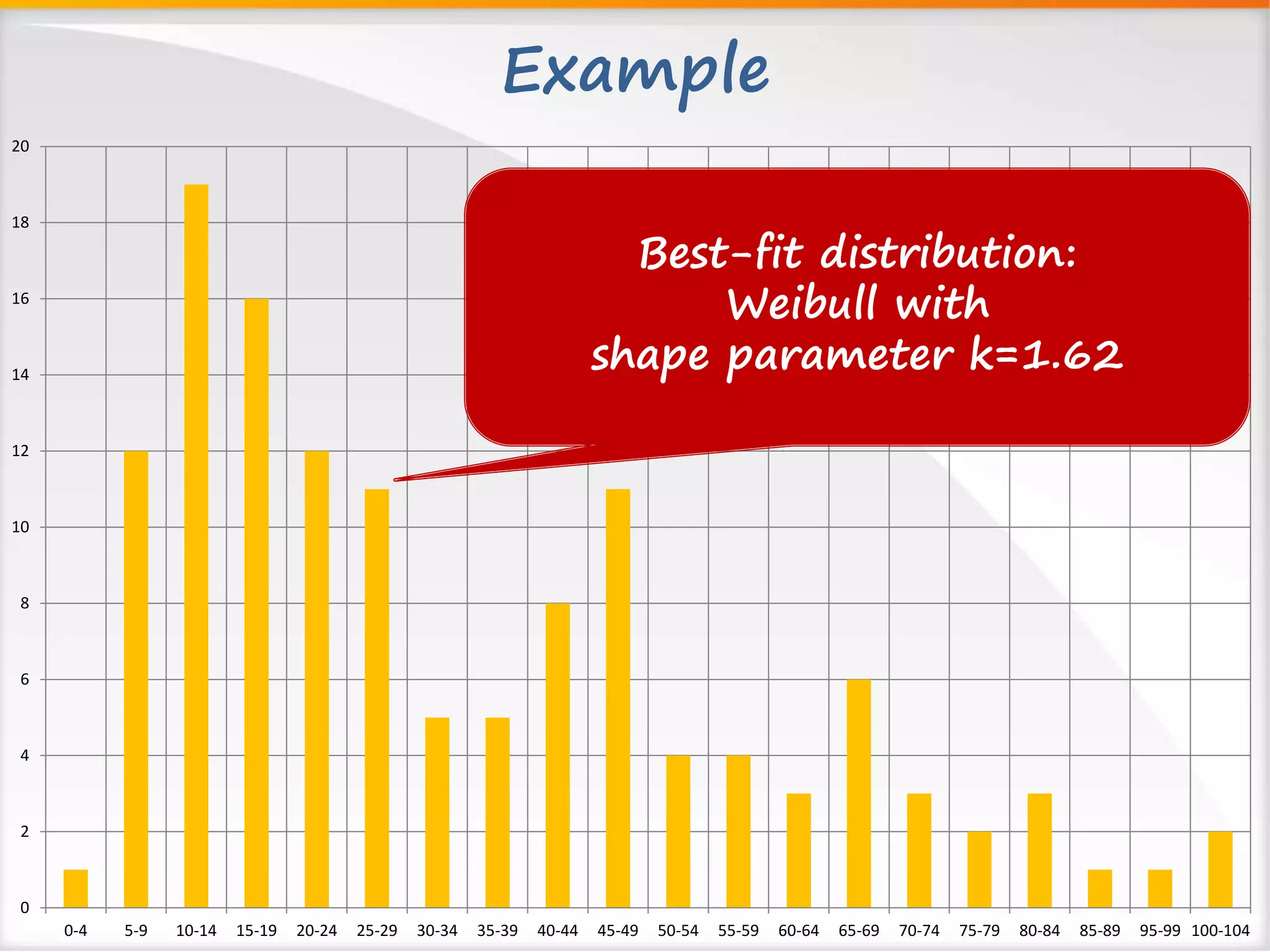

Example
0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104
20
18
16
14
12
10
8
6
4
2
0
Example
Best-fit distribution:
Weibull with
shape parameter k=1.62
0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104
Heterogeneous Demand
Ideas Input Analysis Delivered
Queue
Ready to
Deliver
Development Test
5 2 3
3 ∞
B A
Discarded
C
D
E
G
F
H

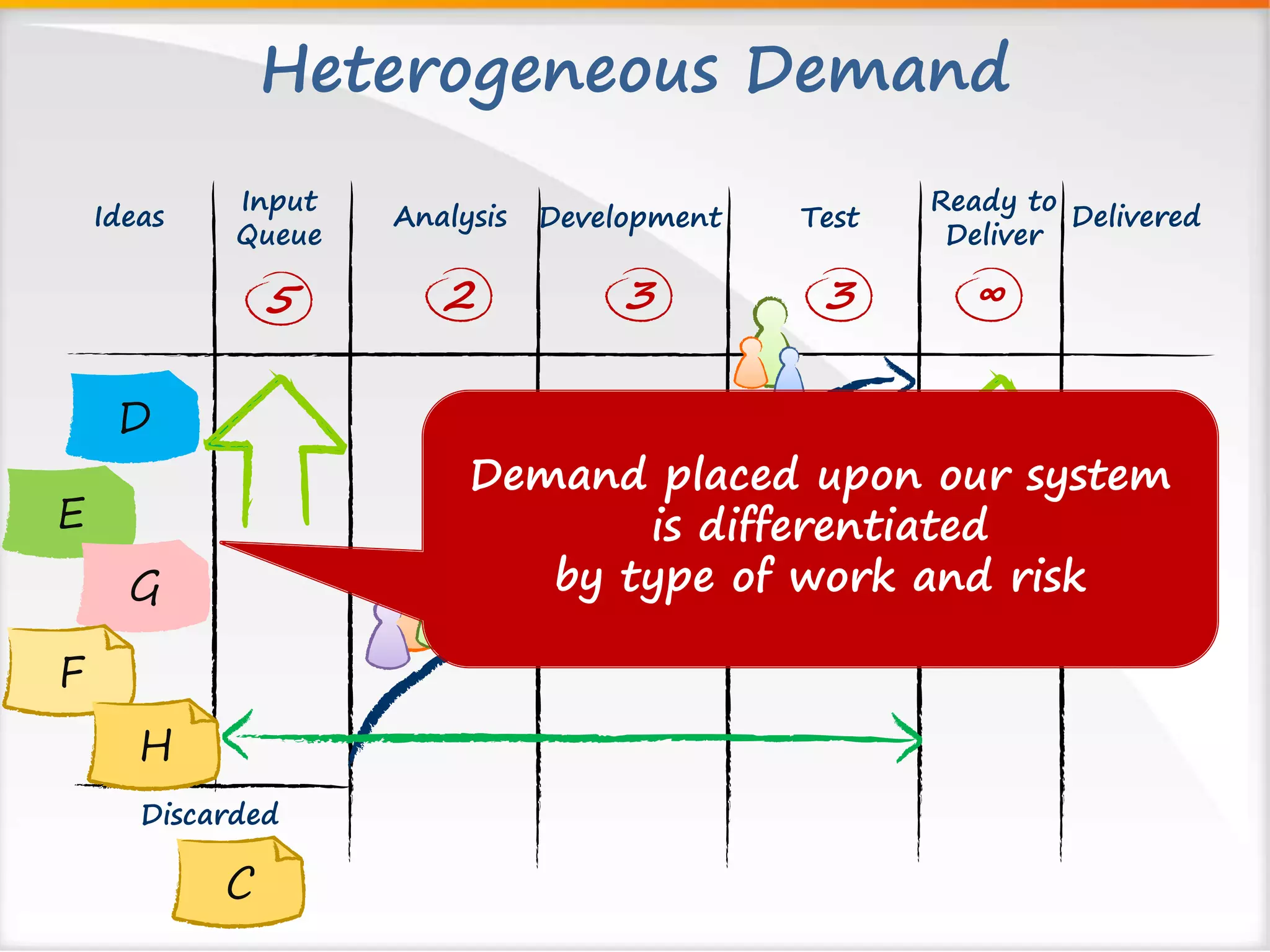

Demand placed upon our system
is differentiated
by type of work and risk

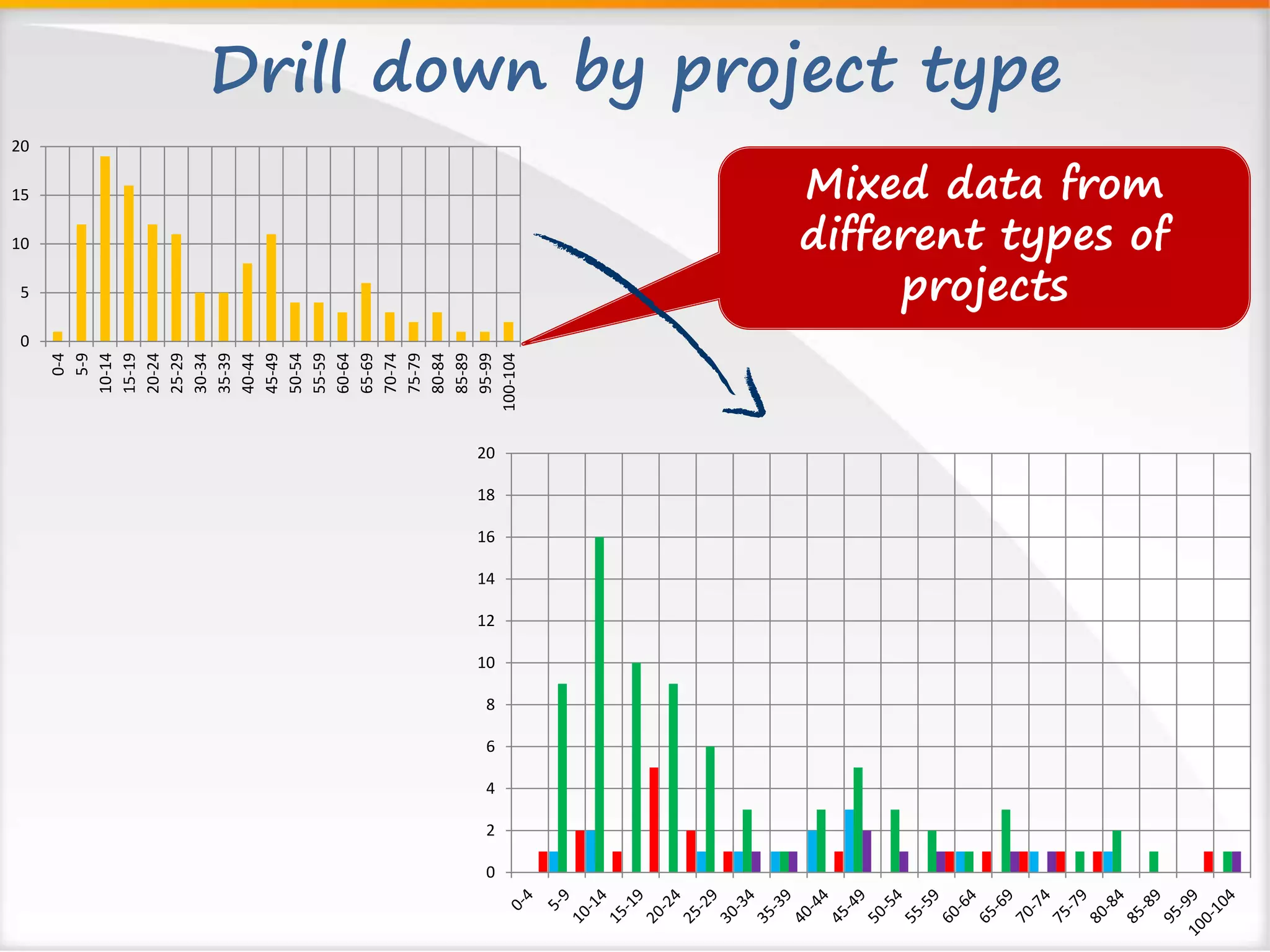

Drill down by project type
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
2
4
6
8
10
12
14
16
18
20
Mixed data from
different types of
projects

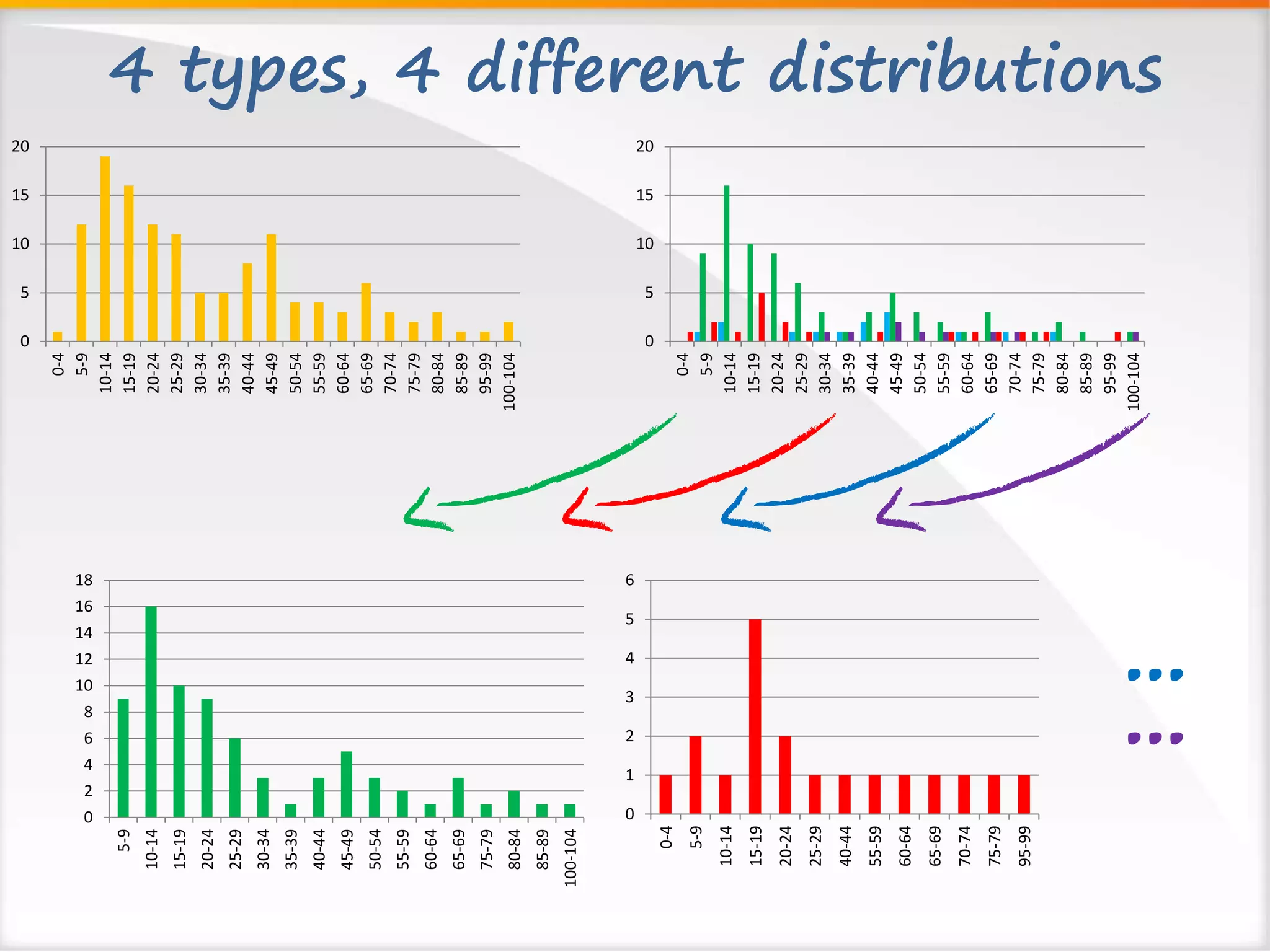

4 types, 4 different distributions
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
2
4
6
8
10
12
14
16
18
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
75-79
80-84
85-89
100-104
0
1
2
3
4
5
6
0-4
5-9
10-14
15-19
20-24
25-29
40-44
55-59
60-64
65-69
70-74
75-79
95-99
...
...
Delivery Expectations
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
Shape Average In 98%
1.62
1.23
1.65
3.22
In 85% of cases
30 d
35 d
40 d
56 d
<51
<63
<68
<78
<83
<112*
<110*
<99
Delivery Expectations
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
0
5
10
15
20
0-4
5-9
10-14
15-19
20-24
25-29
30-34
35-39
40-44
45-49
50-54
55-59
60-64
65-69
70-74
75-79
80-84
85-89
95-99
100-104
Shape Average In 98%
1.62
1.23
1.65
3.22
In 85% of cases
30 d
35 d
40 d
56 d
<51
<63
<68
<78
<83
<112*
<110*
<99

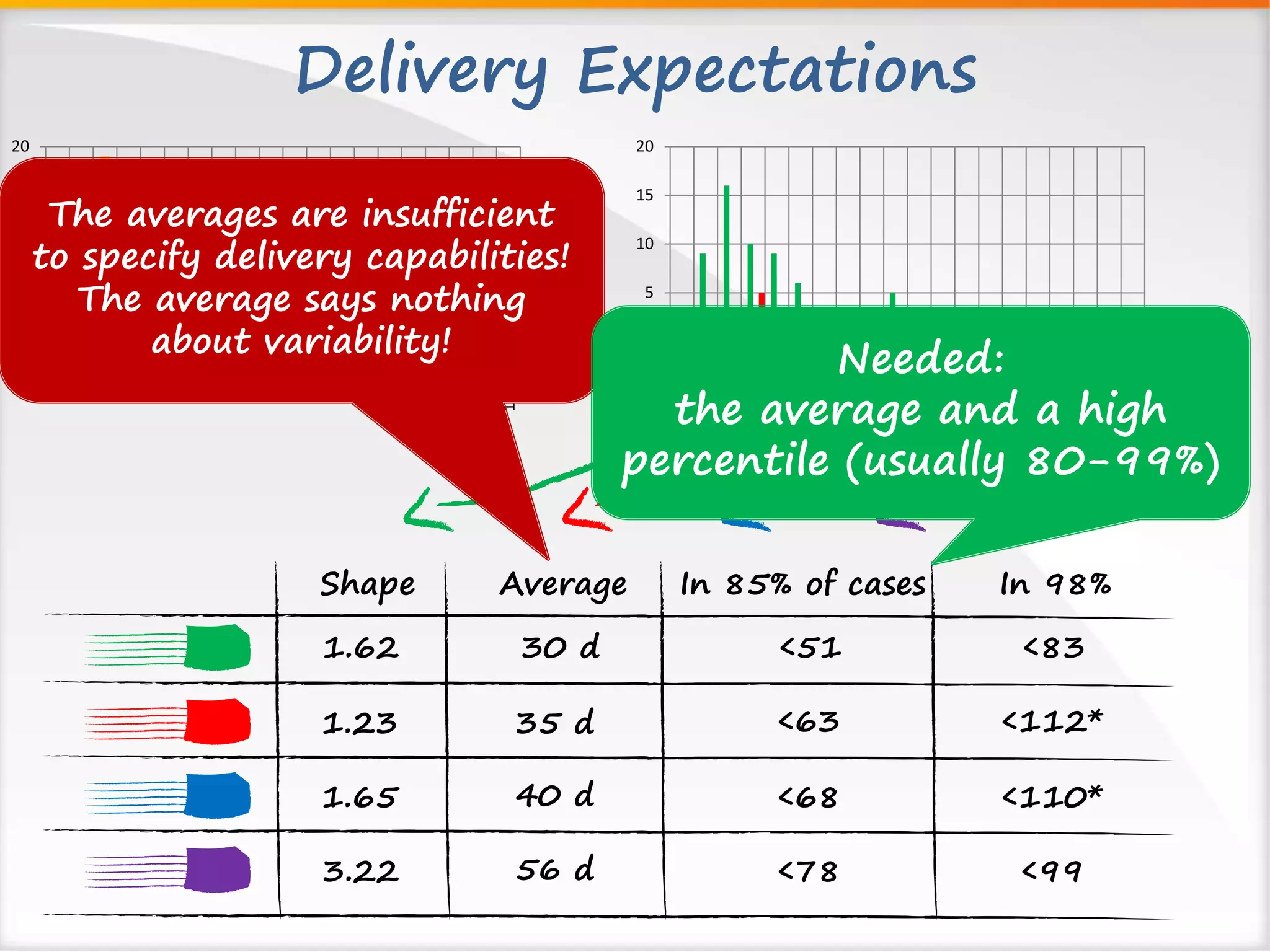

The averages are insufficient
to specify delivery capabilities!
The average says nothing
about variability! Needed:
the average and a high
percentile (usually 80-99%)

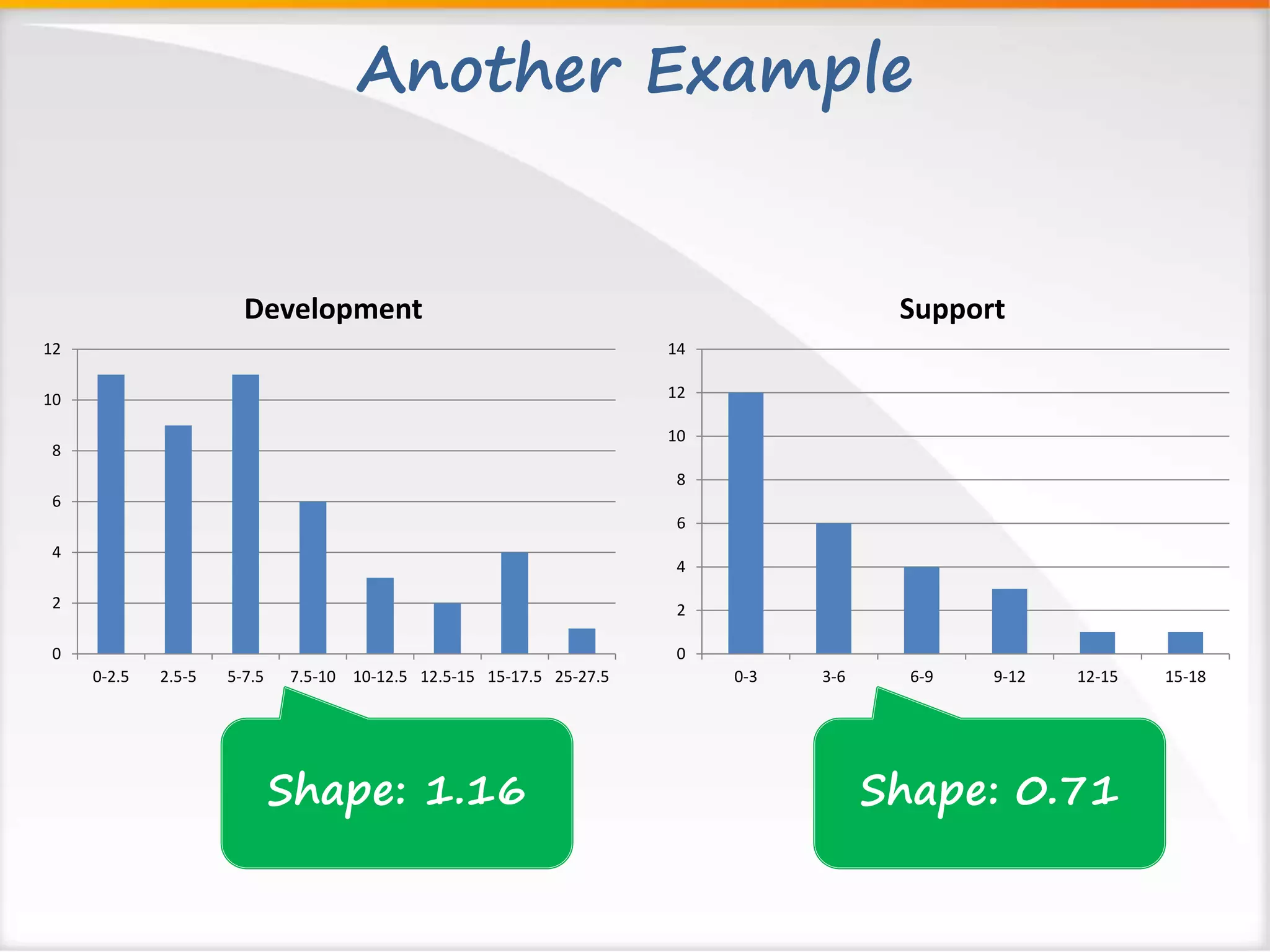

Another Example
12
10
8
6
4
2
0
Development
0-2.5 2.5-5 5-7.5 7.5-10 10-12.5 12.5-15 15-17.5 25-27.5
14
12
10
8
6
4
2
0
Support
0-3 3-6 6-9 9-12 12-15 15-18
Shape: 1.16 Shape: 0.71
Weibull Distributions
Occur Frequently
New product development Operations, support (k<1)
(k>1)
Weibull Distributions
Occur Frequently
New product development Operations, support (k<1)
(k>1)
The unique signature
of your process
How to “Read” a Distribution
Bias
Feedback
Forecast
Scale
Expectations
Control

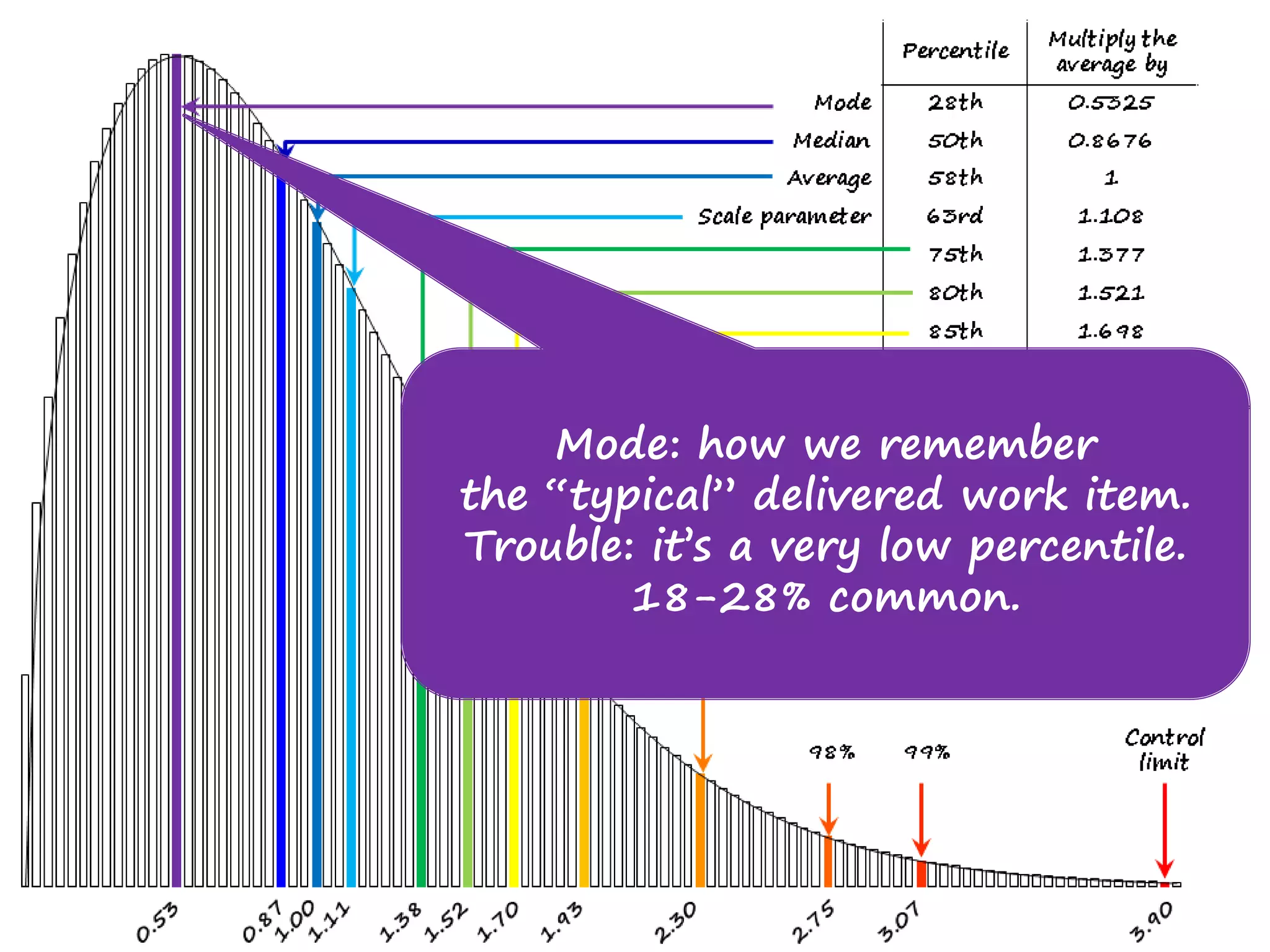

Mode: how we remember
the “typical” delivered work item.
Trouble: it’s a very low percentile.
18-28% common.
Median: 50% more, 50% less.
Perfect for creating
very short feedback loops

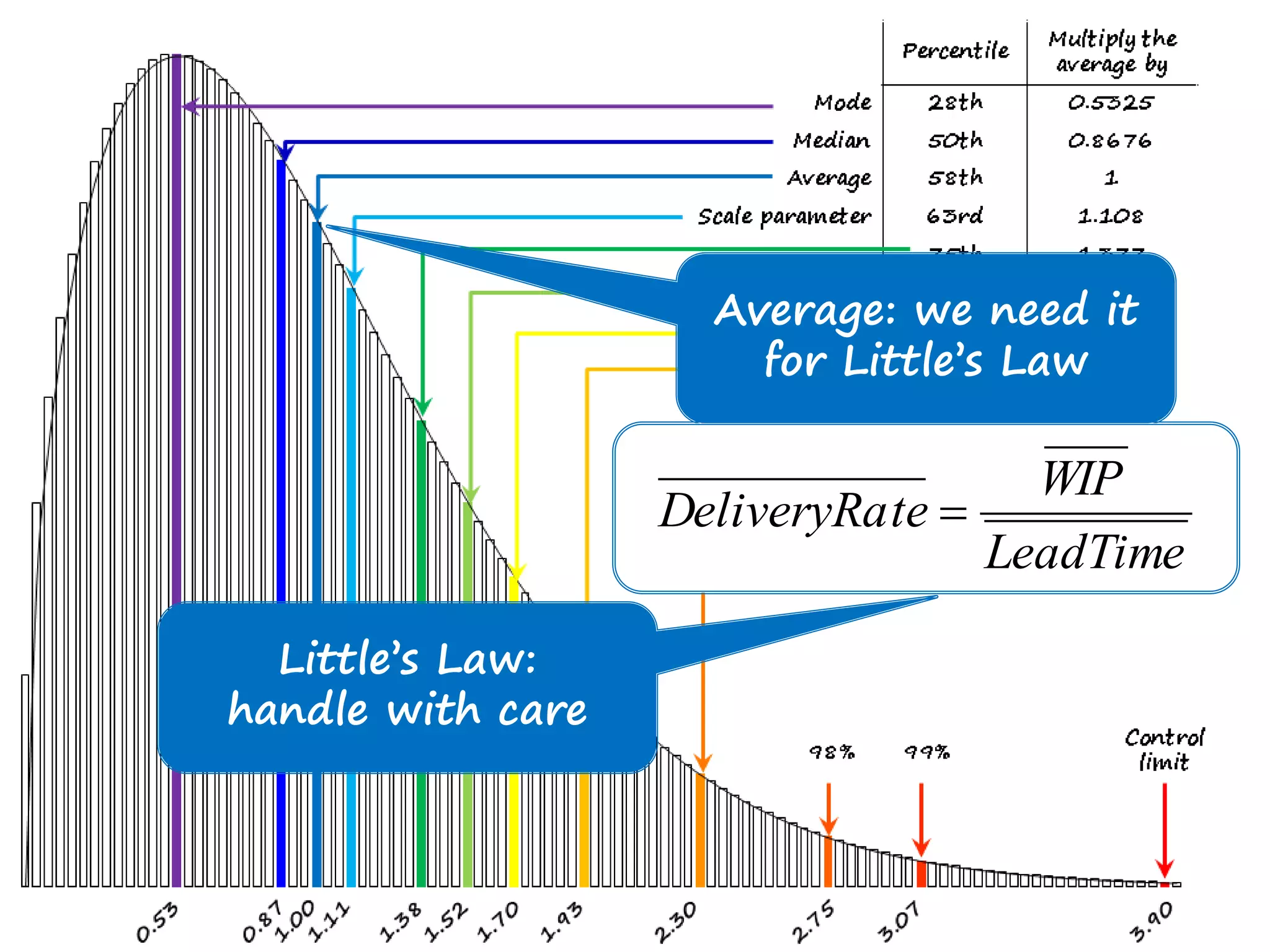

Average: we need it
for Little’s Law
WIP
LeadTime
DeliveryRate 
Little’s Law:
handle with care

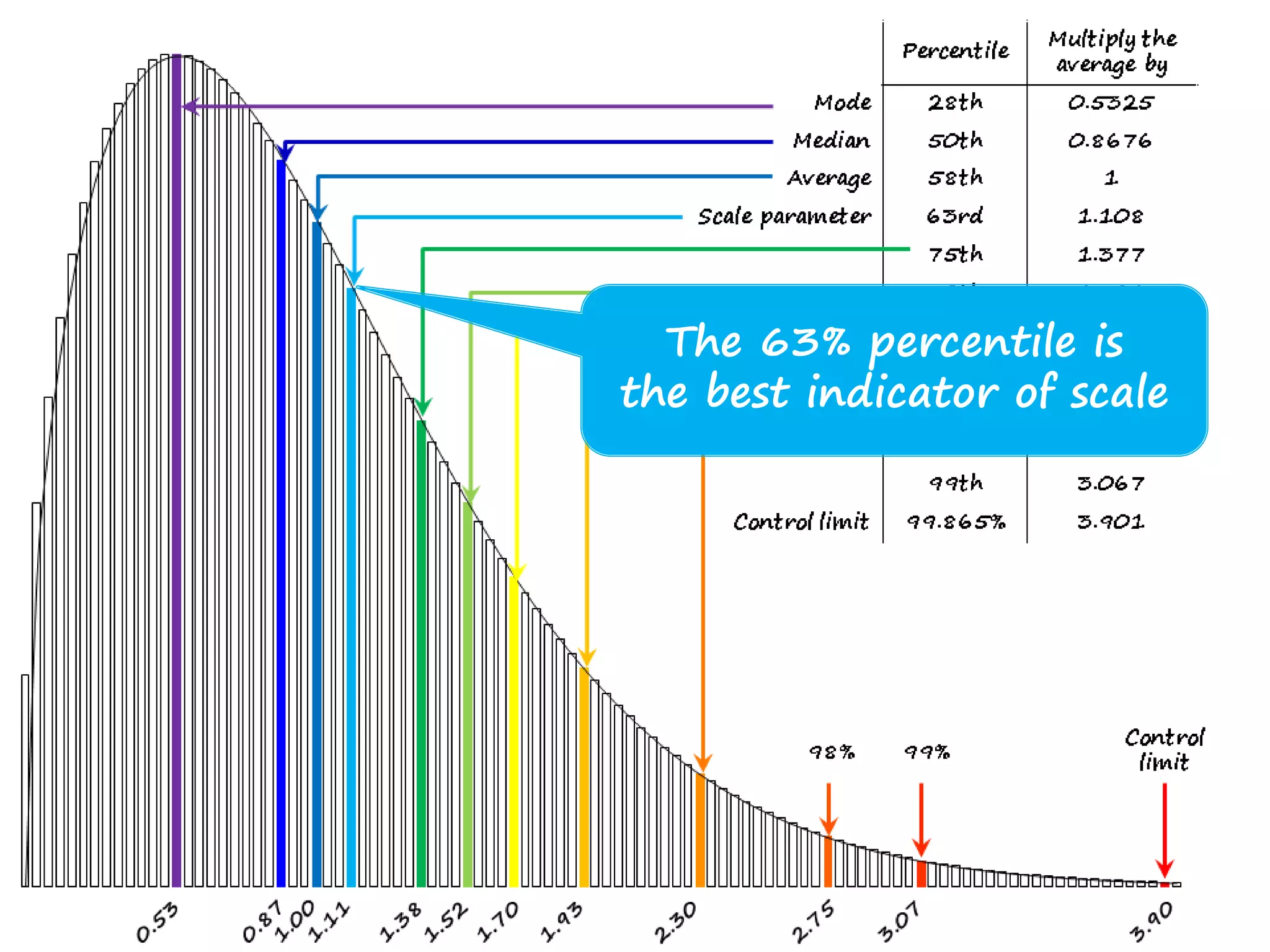

The 63% percentile is
the best indicator of scale

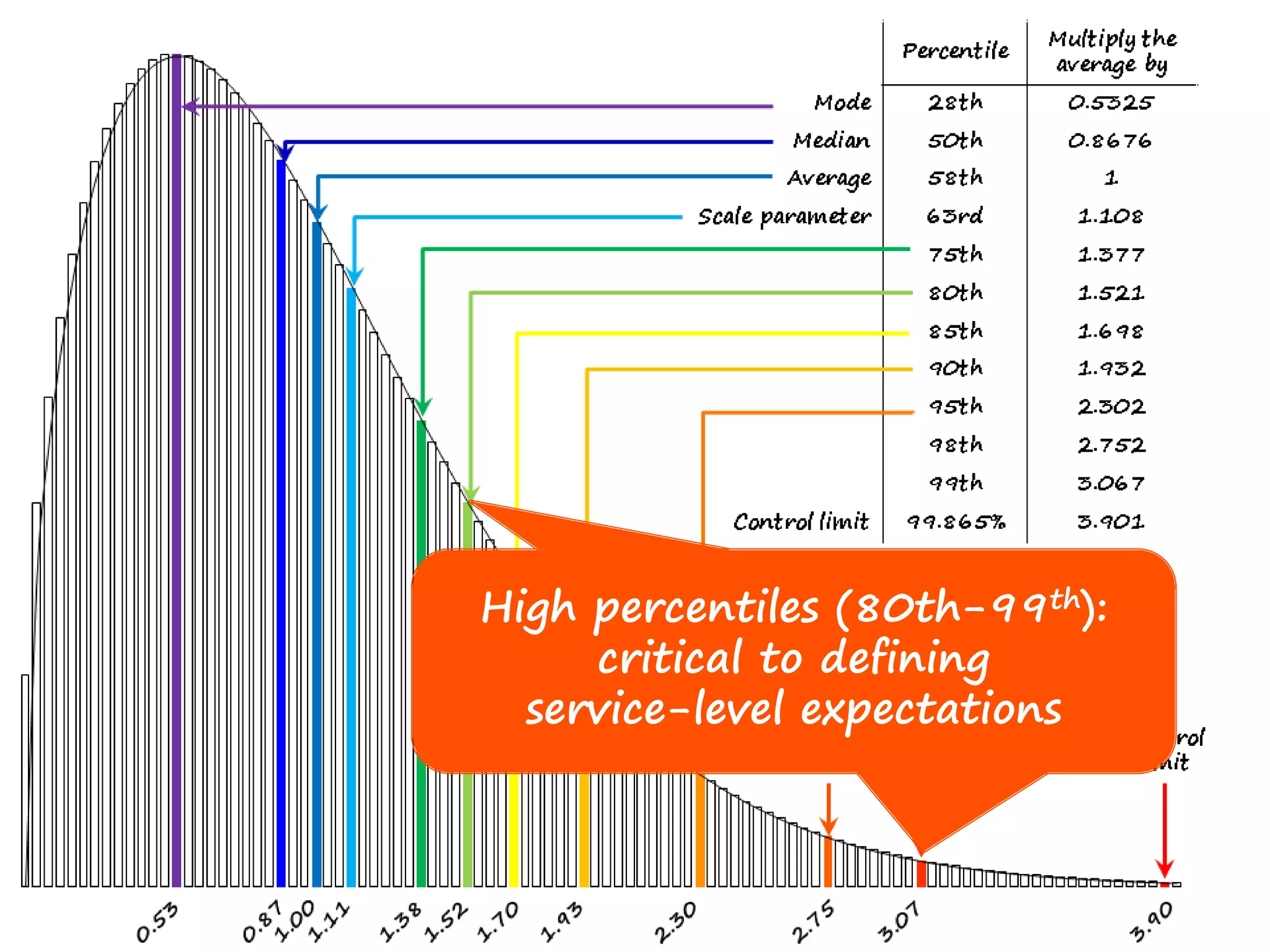

High percentiles (80th-99th):
critical to defining
service-level expectations

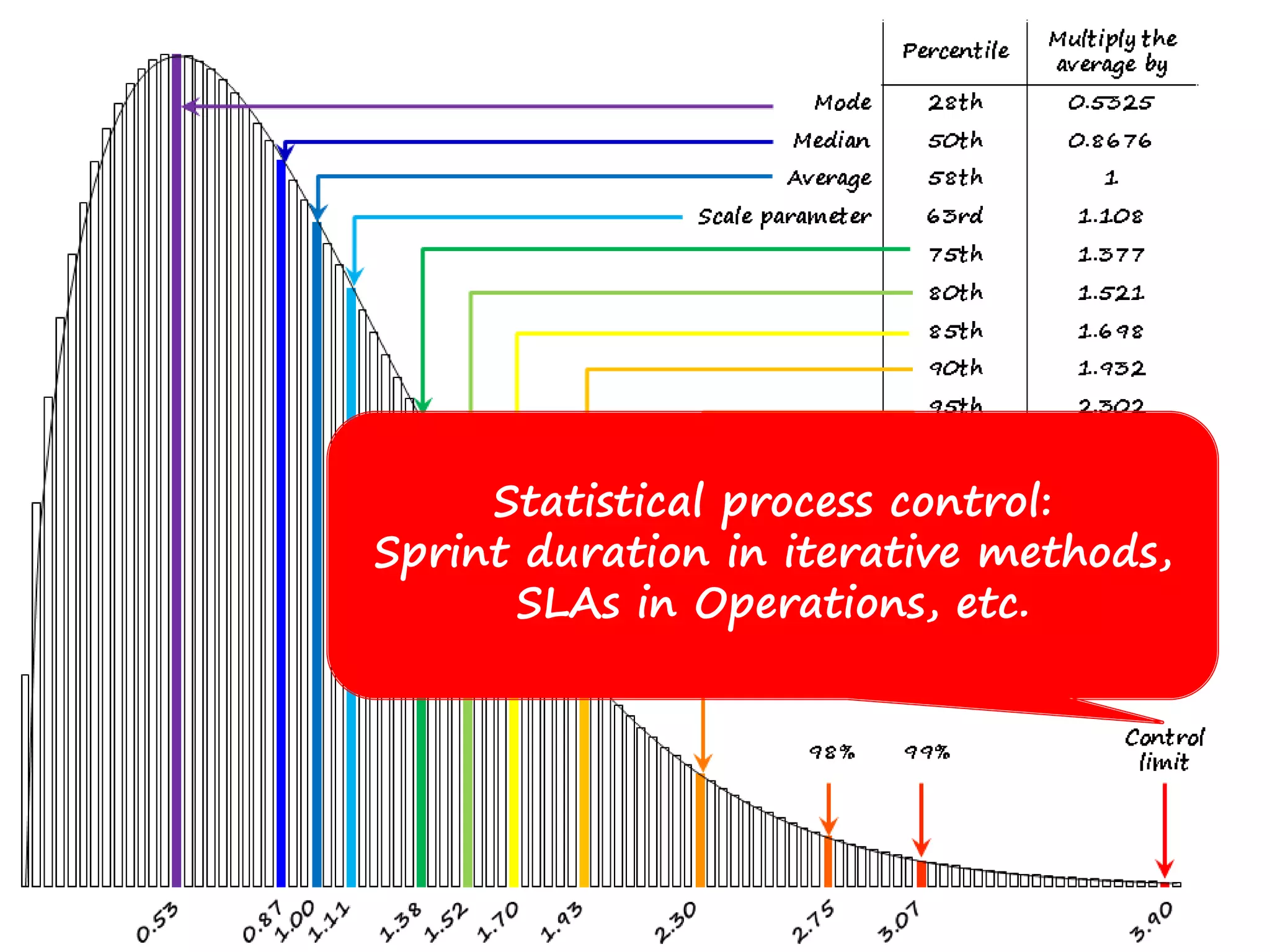

Statistical process control:
Sprint duration in iterative methods,
SLAs in Operations, etc.

Forecasting Cards

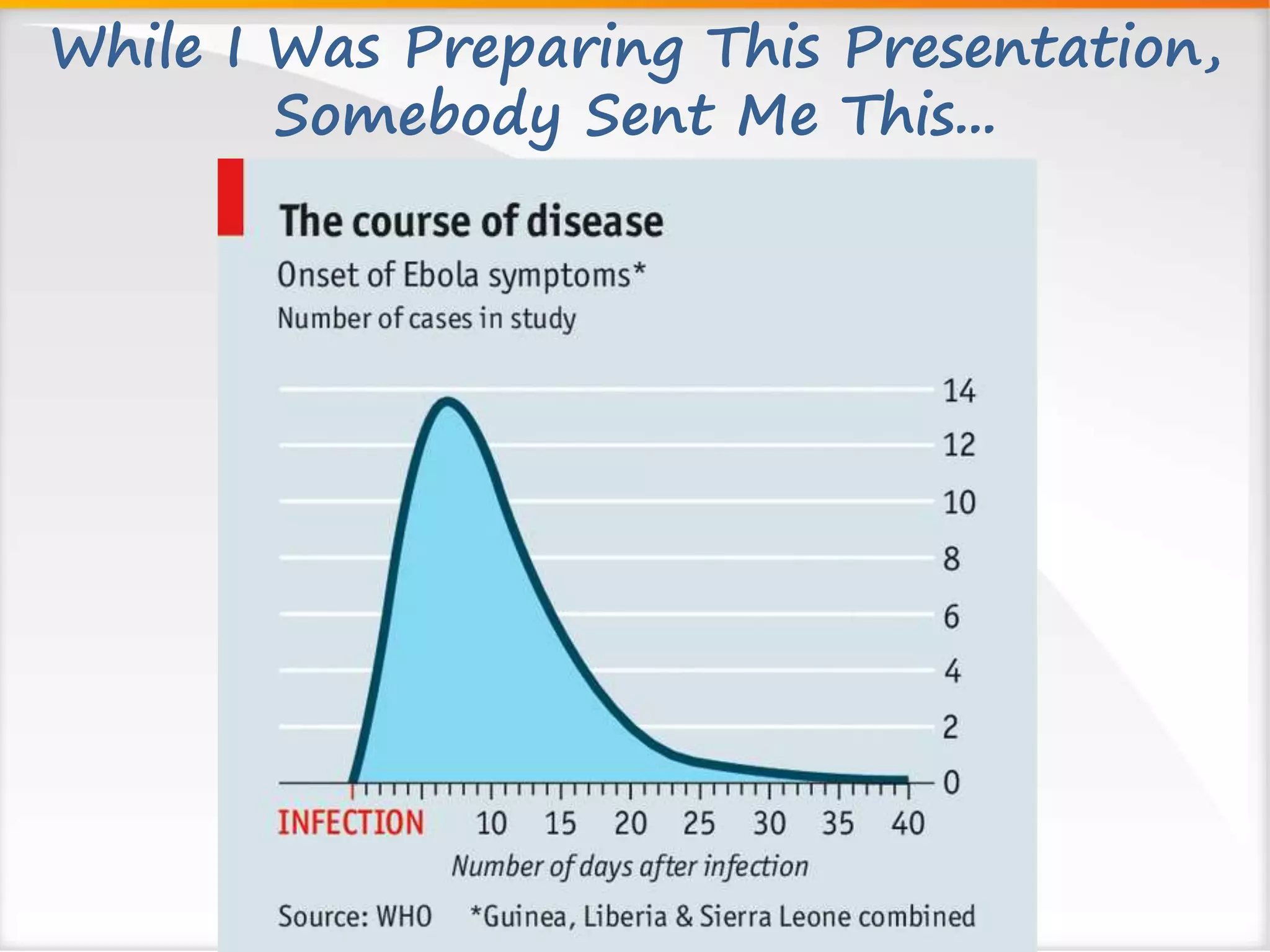

While I Was Preparing This Presentation,
Somebody Sent Me This...

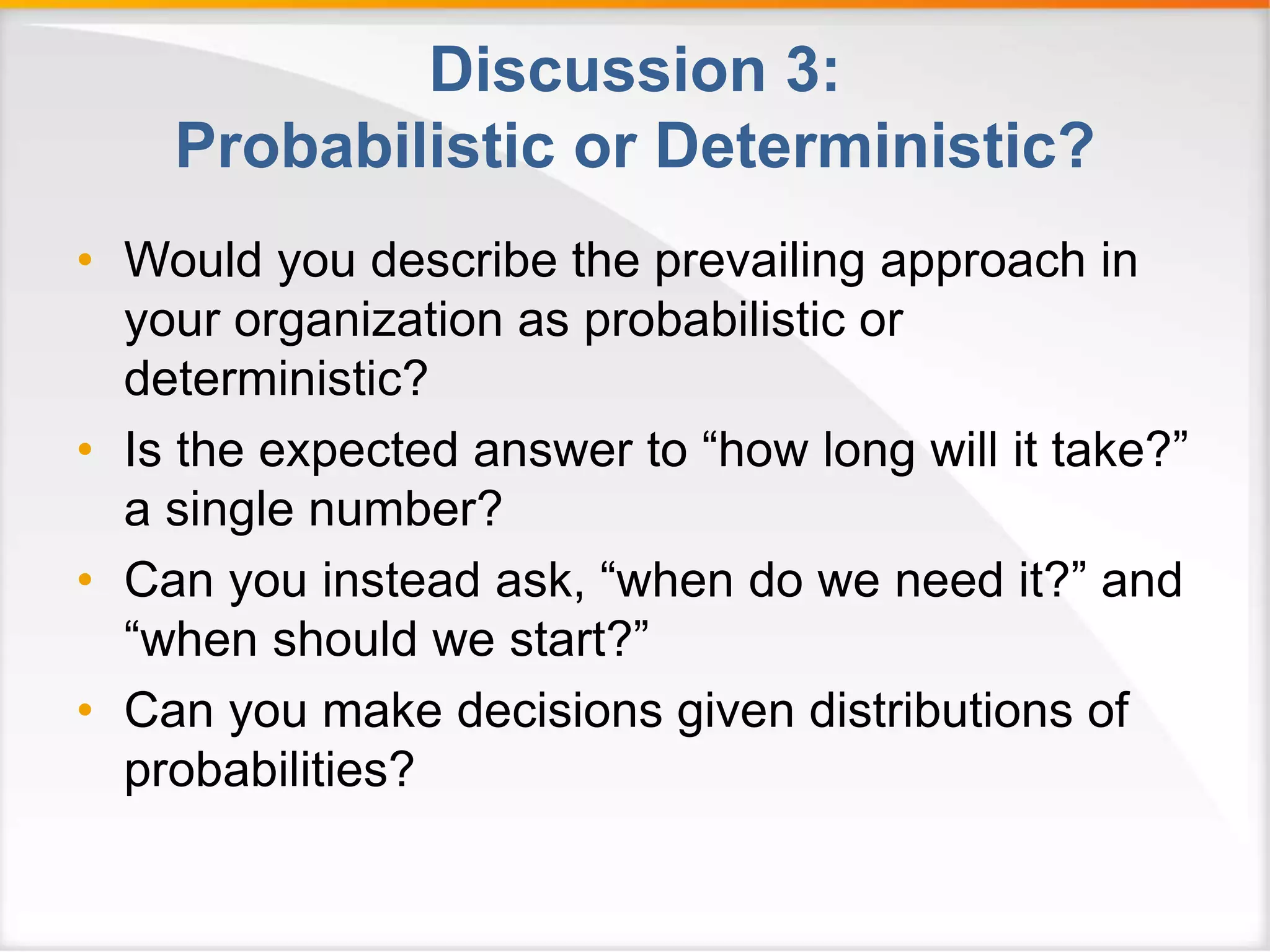

Discussion 3:
Probabilistic or Deterministic?
• Would you describe the prevailing approach in
your organization as probabilistic or
deterministic?
• Is the expected answer to “how long will it take?”
a single number?
• Can you instead ask, “when do we need it?” and
“when should we start?”
• Can you make decisions given distributions of
probabilities?

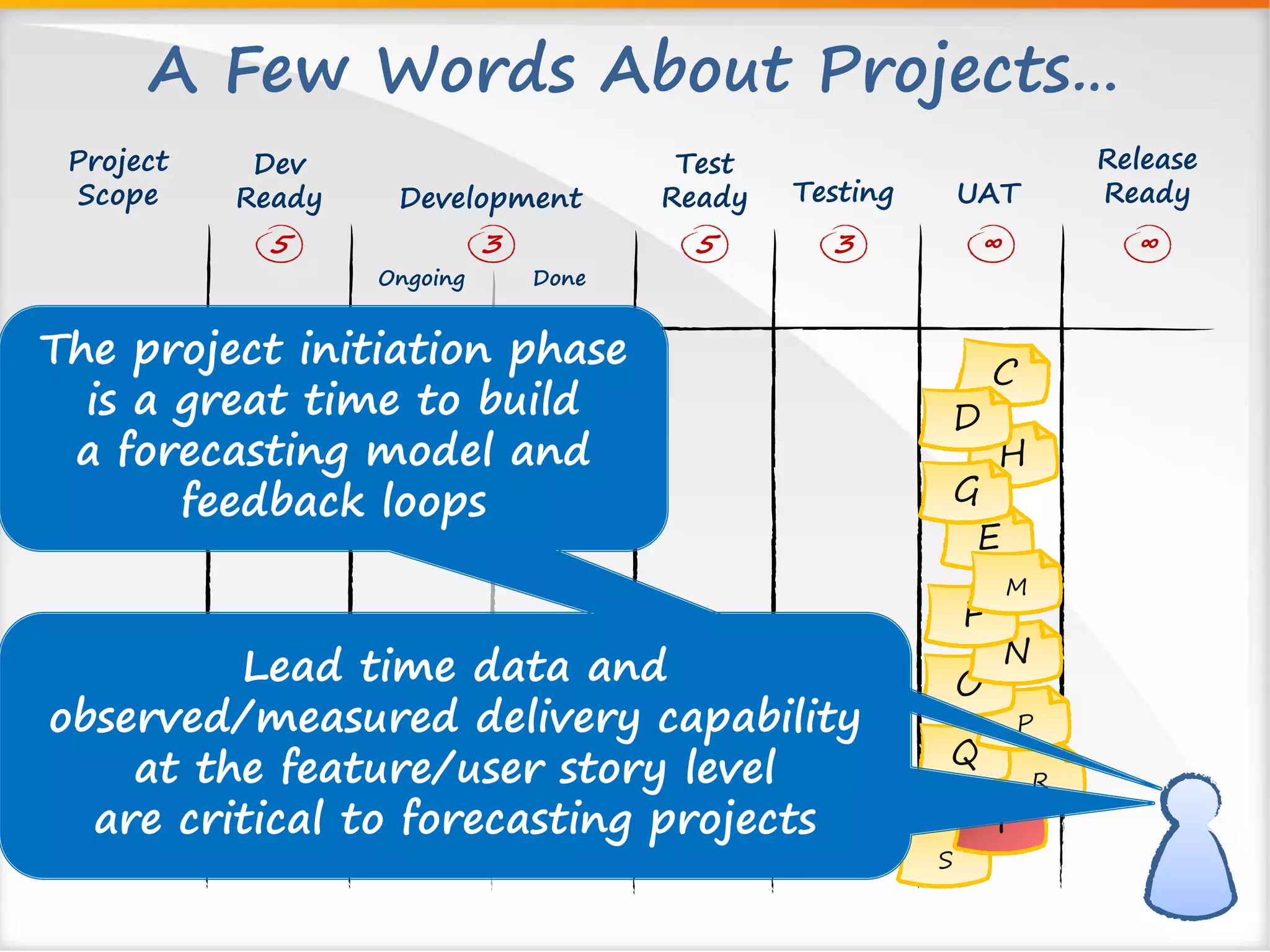

A Few Words About Projects…
Test
Ready
D
S
R
E
Q
P
O
N
F
I
G
M
Dev
Ready
5
Development Testing
Ongoing
3 5 3
Done
UAT
Release
Ready
∞ ∞
Project
Scope
Official training material, used with permission

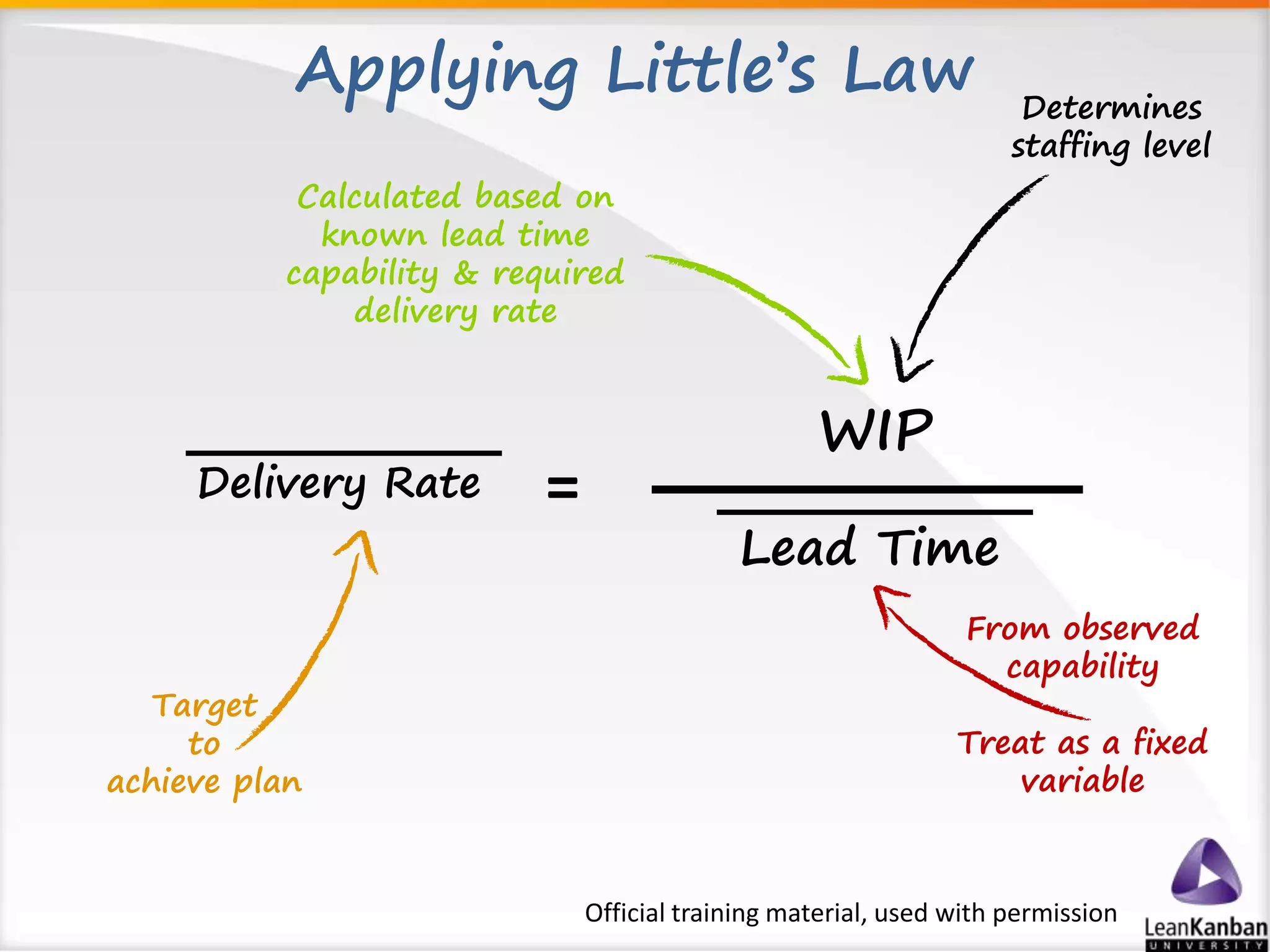

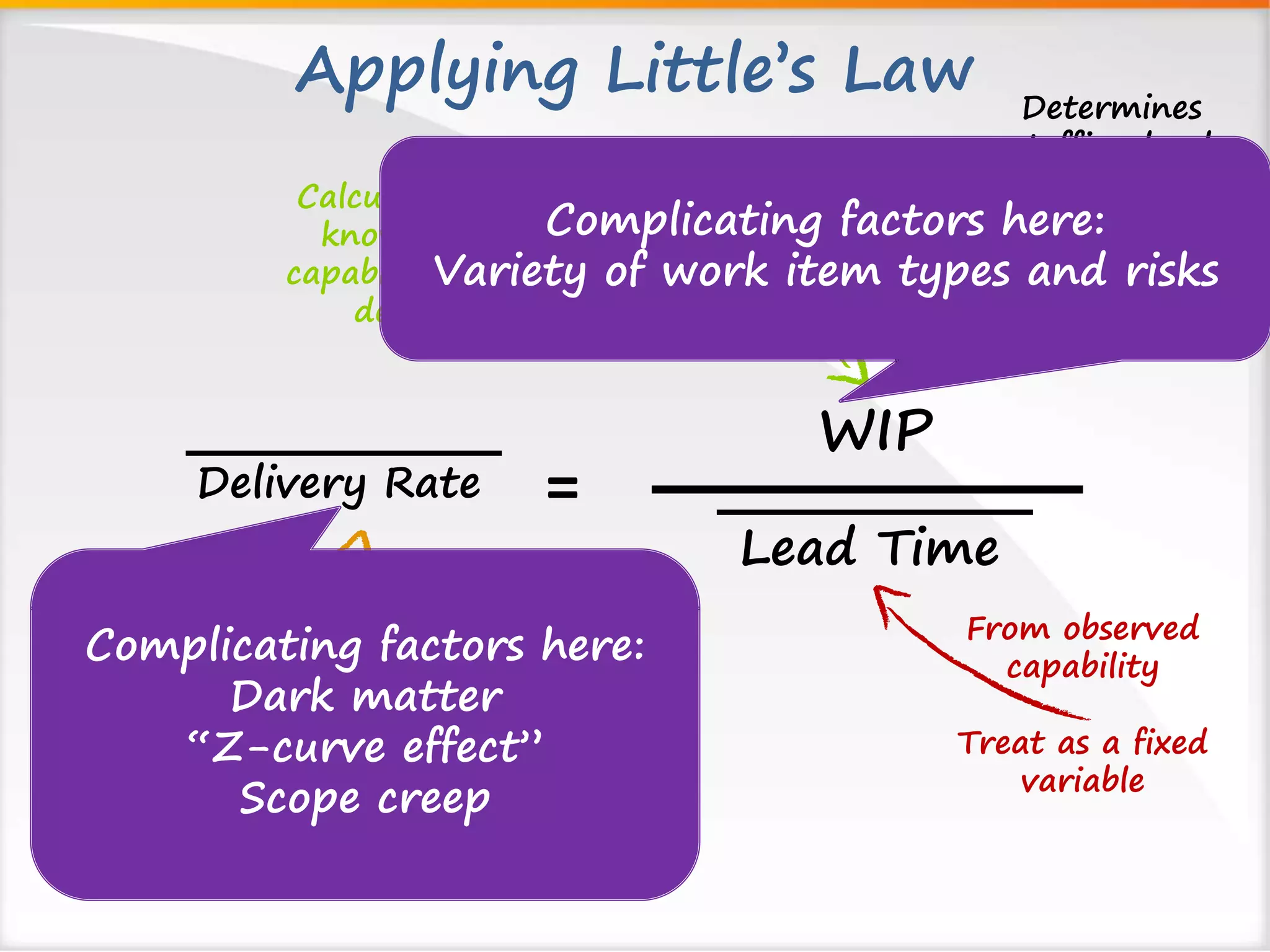

Applying Little’s Law
Calculated based on
known lead time
capability & required
Delivery Rate
WIP
Lead Time
=
From observed
capability
Treat as a fixed
variable
Target
to
achieve plan
delivery rate
Determines
staffing level
Official training material, used with permission
Applying Little’s Law
Calculated based on
known lead time
capability & required
Delivery Rate
WIP
Lead Time
=
From observed
capability
Treat as a fixed
variable
Target
to
achieve plan
delivery rate
Determines
staffing level
Complicating factors here:
Dark matter
“Z-curve effect”
Scope creep
Complicating factors here:
Variety of work item types and risks
Applying Little’s Law
Calculated based on
known lead time
capability & required
Delivery Rate
WIP
Lead Time
=
From observed
capability
Treat as a fixed
variable
Target
to
achieve plan
delivery rate
Determines
staffing level
Complicating factors here:
Dark matter
“Z-curve effect”
Scope creep
Complicating factors here:
Variety of work item types and risks
A Few Words About Projects…
Test
Ready
D
S
R
E
Q
P
O
N
F
I
G
M
Dev
Ready
5
Development Testing
Ongoing
3 5 3
Done
UAT
Release
Ready
∞ ∞
Project
Scope
The project initiation phase
is a great time to build
a forecasting model and
feedback loops
Lead time data and
observed/measured delivery capability
at the feature/user story level
are critical to forecasting projects
New Kanban Book
Mike Burrows
Influencers
Troy Magennis Dimitar Bakardzhiev David J Anderson
Dan Vacanti Dave White Frank Vega
Discussion 4: What Now?
• What new ideas have your learned in this
session today?
• What will you do differently when you return to
your office tomorrow?
Alexei Zheglov
connected-knowledge.com (blog)
alex@LeanAtoZ.com
@az1

Agile DC Lead Time

  • 1.
    Lead Time: WhatWe Know About It And How It Can Help Forecast Your Projects Alexei Zheglov Agile DC Washington, October 2014
  • 2.
  • 3.
  • 4.
    Goodhart’s Law “Whena measure becomes a target, it ceases to be a good measure.”
  • 5.
    Kanban System LeadTime Ideas Input Analysis Delivered Queue Ready to Deliver Development Test 5 2 3 3 ∞ Lead Time The First Commitment Point B A Discarded C D
  • 6.
    Ask Not IdeasInput Analysis Delivered Queue Ready to Deliver Development Test 5 2 3 3 ∞ B A Lead Time Discarded C D Not “how long will it take?”
  • 7.
    Do Ask IdeasInput Analysis Delivered Queue Ready to Deliver Development Test 5 2 3 3 ∞ B A Lead Time Discarded C D When should we start? When do we need it?
  • 8.
    Decide Ideas InputAnalysis Delivered Queue Ready to Deliver Development Test 5 2 3 3 ∞ B A Lead Time Discarded C D One event precedes (leads) another one by this much
  • 9.
    Why? Ideas InputAnalysis Delivered Queue Ready to Deliver Development Test 5 2 3 3 ∞ Lead Time The First Commitment Point B A Discarded C D Includes the time the work item spent as an option Depends on the transaction costs (external to the system) Measures the true delivery capability
  • 10.
    Customer Lead Time Ideas Input Activity 1 Delivered Queue Output Buffer Activity 2 Activity 3 ? ? ? ? ∞ Kanban system(s) lead time B A Customer Lead Time + time spent in the unlimited buffer(s) Discarded C D
  • 11.
    (Local) Cycle Time Ideas Input Activity 1 Delivered Queue Output Buffer Activity 2 Activity 3 ? ? ? ? ∞ B A Discarded C D Cycle time is always local Always qualify where it is from and to Often depends mainly on the size of the local effort
  • 12.
    Discussion 1: GamingMetrics • Given the goal to reduce the lead time (as we have just defined it), what would you do? • What would happen, good and bad? • How can you game the local cycle time metric? • Bonus question: if your delivery time metric included the time before commitment, what would you be motivated to do?
  • 13.
    Flow Efficiency Ready to Test F Development Testing 3 5 3 E J G D GY BG P1 DE NP AB Wait Work Wait Work Customer Lead Time Ideas Ready to Dev 5 IP Done UAT Ready to Deliver ∞ ∞ Work Work Wait Official training material, used with permission
  • 14.
    Flow Efficiency Ready to Test F Development Testing 3 5 3 E J G D GY BG P1 DE NP AB Wait Work Wait Work Customer Lead Time Ideas Ready to Dev 5 IP Done UAT Ready to Deliver ∞ ∞ Work Work Wait Official training material, used with permission Work is waiting Work is still waiting! Multitasking creates hidden queues!
  • 15.
    Flow Efficiency Ready to Test F Development Testing 3 5 3 touch time E J G D flow efficiency   GY BG P1 elapsed time DE NP AB Wait Work Wait Work 100% Customer Lead Time Ideas Ready to Dev 5 IP Done UAT Ready to Deliver ∞ ∞ Work Work Wait Official training material, used with permission
  • 16.
    Measuring Flow Efficiency Ready to Test F Development Testing 3 5 3 E J G D GY BG P1 DE NP AB Wait Work Wait Work Customer Lead Time Ideas Ready to Dev 5 IP Done UAT Ready to Deliver ∞ ∞ Sampling Work Work Wait Official training material, used with permission Timesheets are not necessary! Rough approximations (±5%) are often sufficient In Aggregate
  • 17.
    Measuring Flow Efficiency Ready to Test F Development Testing 3 5 3 The results are often between 1% and 5%* The result is not limited to the number! E J G D What did you decide to do? GY BG P1 DE NP AB Wait Work Wait Work Customer Lead Time Ideas Ready to Dev 5 IP Done UAT Ready to Deliver ∞ ∞ Work Work Wait *-Zsolt Fabok, Lean Agile Scotland 2012, LKFR12; Hakan Forss, LKFR13
  • 18.
    If the FlowEfficiency Is 5%... If... Before After Improvement Hire 10x engineers 100 95.5 +4.7% The task is three times bigger 100 110 -9.1% The task is three times smaller 100 96.7 +3.4% Reduce delays by half 100 52.5 +90%
  • 19.
    Consequences of LowFlow Efficiency • Lead time is hard to fudge • Lead time improves primarily due to system-level improvements • The lead time data from your previous projects likely relevant to the upcoming one
  • 20.
    Goodhart’s Law’s Corollary Measuring the delivery time cannot be separated from understanding commitment.
  • 21.
  • 22.
    Discussion 2: MeasuringLead Time • Do you already collect lead time data? • If not, do you already have these data available somewhere, waiting for you to discover them? • If not, would it be difficult or easy to start? • What would you do differently in your company with respect to lead time data after this presentation?
  • 23.
    probabilistic Deterministic approach to a probabilistic process? !!!
  • 24.
    20 18 16 14 12 10 8 6 4 2 0 Example 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104
  • 25.
    20 18 16 14 12 10 8 6 4 2 0 Example Best-fit distribution: Weibull with shape parameter k=1.62 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104
  • 26.
    Heterogeneous Demand IdeasInput Analysis Delivered Queue Ready to Deliver Development Test 5 2 3 3 ∞ B A Discarded C D E G F H Demand placed upon our system is differentiated by type of work and risk
  • 27.
    Drill down byproject type 0 5 10 15 20 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104 0 2 4 6 8 10 12 14 16 18 20 Mixed data from different types of projects
  • 28.
    4 types, 4different distributions 0 5 10 15 20 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104 0 5 10 15 20 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104 0 2 4 6 8 10 12 14 16 18 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 75-79 80-84 85-89 100-104 0 1 2 3 4 5 6 0-4 5-9 10-14 15-19 20-24 25-29 40-44 55-59 60-64 65-69 70-74 75-79 95-99 ... ...
  • 29.
    Delivery Expectations 0 5 10 15 20 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104 0 5 10 15 20 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104 Shape Average In 98% 1.62 1.23 1.65 3.22 In 85% of cases 30 d 35 d 40 d 56 d <51 <63 <68 <78 <83 <112* <110* <99
  • 30.
    Delivery Expectations 0 5 10 15 20 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104 0 5 10 15 20 0-4 5-9 10-14 15-19 20-24 25-29 30-34 35-39 40-44 45-49 50-54 55-59 60-64 65-69 70-74 75-79 80-84 85-89 95-99 100-104 Shape Average In 98% 1.62 1.23 1.65 3.22 In 85% of cases 30 d 35 d 40 d 56 d <51 <63 <68 <78 <83 <112* <110* <99 The averages are insufficient to specify delivery capabilities! The average says nothing about variability! Needed: the average and a high percentile (usually 80-99%)
  • 31.
    Another Example 12 10 8 6 4 2 0 Development 0-2.5 2.5-5 5-7.5 7.5-10 10-12.5 12.5-15 15-17.5 25-27.5 14 12 10 8 6 4 2 0 Support 0-3 3-6 6-9 9-12 12-15 15-18 Shape: 1.16 Shape: 0.71
  • 32.
    Weibull Distributions OccurFrequently New product development Operations, support (k<1) (k>1)
  • 33.
    Weibull Distributions OccurFrequently New product development Operations, support (k<1) (k>1) The unique signature of your process
  • 34.
    How to “Read”a Distribution Bias Feedback Forecast Scale Expectations Control
  • 35.
    Mode: how weremember the “typical” delivered work item. Trouble: it’s a very low percentile. 18-28% common.
  • 36.
    Median: 50% more,50% less. Perfect for creating very short feedback loops
  • 37.
    Average: we needit for Little’s Law WIP LeadTime DeliveryRate  Little’s Law: handle with care
  • 38.
    The 63% percentileis the best indicator of scale
  • 39.
    High percentiles (80th-99th): critical to defining service-level expectations
  • 40.
    Statistical process control: Sprint duration in iterative methods, SLAs in Operations, etc.
  • 41.
  • 42.
    While I WasPreparing This Presentation, Somebody Sent Me This...
  • 43.
    Discussion 3: Probabilisticor Deterministic? • Would you describe the prevailing approach in your organization as probabilistic or deterministic? • Is the expected answer to “how long will it take?” a single number? • Can you instead ask, “when do we need it?” and “when should we start?” • Can you make decisions given distributions of probabilities?
  • 44.
    A Few WordsAbout Projects… Test Ready D S R E Q P O N F I G M Dev Ready 5 Development Testing Ongoing 3 5 3 Done UAT Release Ready ∞ ∞ Project Scope Official training material, used with permission
  • 45.
    Applying Little’s Law Calculated based on known lead time capability & required Delivery Rate WIP Lead Time = From observed capability Treat as a fixed variable Target to achieve plan delivery rate Determines staffing level Official training material, used with permission
  • 46.
    Applying Little’s Law Calculated based on known lead time capability & required Delivery Rate WIP Lead Time = From observed capability Treat as a fixed variable Target to achieve plan delivery rate Determines staffing level Complicating factors here: Dark matter “Z-curve effect” Scope creep Complicating factors here: Variety of work item types and risks
  • 47.
    Applying Little’s Law Calculated based on known lead time capability & required Delivery Rate WIP Lead Time = From observed capability Treat as a fixed variable Target to achieve plan delivery rate Determines staffing level Complicating factors here: Dark matter “Z-curve effect” Scope creep Complicating factors here: Variety of work item types and risks
  • 48.
    A Few WordsAbout Projects… Test Ready D S R E Q P O N F I G M Dev Ready 5 Development Testing Ongoing 3 5 3 Done UAT Release Ready ∞ ∞ Project Scope The project initiation phase is a great time to build a forecasting model and feedback loops Lead time data and observed/measured delivery capability at the feature/user story level are critical to forecasting projects
  • 49.
    New Kanban Book Mike Burrows
  • 50.
    Influencers Troy MagennisDimitar Bakardzhiev David J Anderson Dan Vacanti Dave White Frank Vega
  • 51.
    Discussion 4: WhatNow? • What new ideas have your learned in this session today? • What will you do differently when you return to your office tomorrow?
  • 52.
    Alexei Zheglov connected-knowledge.com(blog) alex@LeanAtoZ.com @az1
