Indexes to Monitor Progress

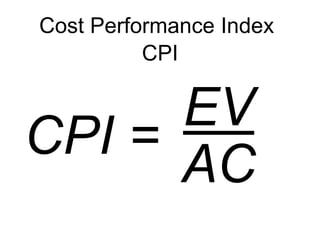

Cost Performance Index
CPI
CPI =
EV
AC
Cost Performance Index
(CPI)CPI

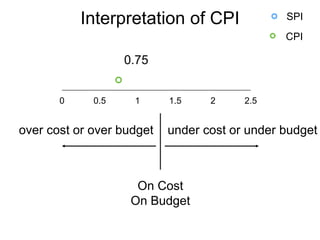

TABLE 13.3
Interpretation of CPI
0 0.5 1 1.5 2 2.5
SPI
CPI
under cost or under budgetover cost or over budget
On Cost
On Budget

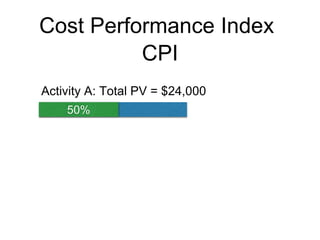

Cost Performance Index
(CPI)

Activity A: Total PV = $24,000
CPI
Cost Performance Index
(CPI)
50%
Activity A: Total PV = $24,000
(CPI)CPI
Cost Performance Index
(CPI)
Activity A: Total PV = $24,000
50%
EV= $24,000
AC =
* 50% = $12,000
CPI
EV $12,000
$16,000

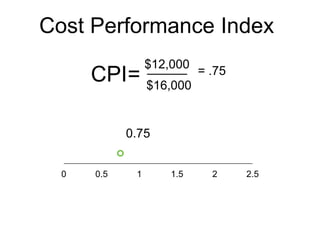

Cost Performance Index
CPI
$12,000
= = .75

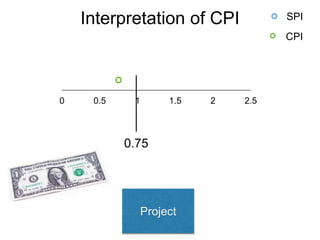

0 0.5 1 1.5 2 2.5
0.75
$16,000

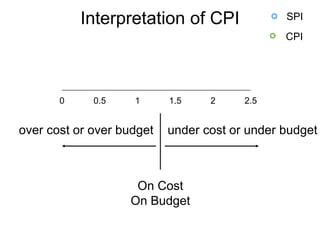

TABLE 13.3
Interpretation of CPI
0 0.5 1 1.5 2 2.5
SPI
CPI
under cost or under budgetover cost or over budget
On Cost
On Budget
0.75
Interpretation of CPI
0 0.5 1 1.5 2 2.5
SPI
CPI
Project
0.75
Cost Performance Index
(CPI)
Activity A: Total PV = $24,000
CPI
Cost Performance Index
(CPI)
50%
Activity A: Total PV = $24,000
(CPI)CPI
Cost Performance Index
(CPI)
Activity A: Total PV = $24,000
50%
EV= $24,000
AC =
* 50% = $12,000
CPI
EV $12,000
$9,600
Cost Performance Index
CPI
$12,000
= = 1.25
$9,600
0 0.5 1 1.5 2 2.5
1.25

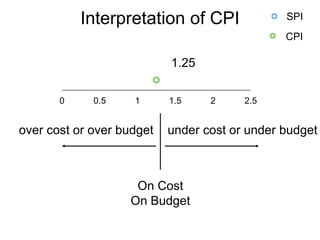

TABLE 13.3
Interpretation of CPI
0 0.5 1 1.5 2 2.5
SPI
CPI
under cost or under budgetover cost or over budget
On Cost
On Budget
1.25
Interpretation of CPI
0 0.5 1 1.5 2 2.5
SPI
CPI
1.25
Project

Cost Performance Index (CPI)

Editor's Notes

  • #3 Measures the cost efficiency of work accomplished to date. Are we burning through the money at the rate that we thought we would. CPI = EV/AC. Measures Costs Effectiveness
  • #4 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #6 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #7 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #8 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #9 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #11 For every $1.00 of work I put into the project, I a
  • #12 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #13 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #14 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #15 Scheduling Performance Index (SPI) Measures scheduling efficiency SPI = EV/PV
  • #17 For every $1.00 of work I put into the project, I a
