Earned
Value
Analysis
Earned Value Analysis

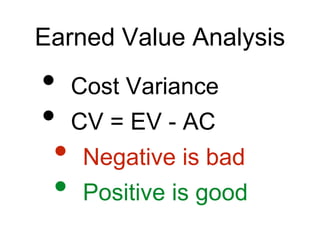

• Cost Variance
• CV = EV - AC
• Negative is bad
• Positive is good
Creating a Time-Phased
BudgetTask
Activity

Budget (PV) Week 1 Week 2 Week 3 Week 4 Week 5 Week 6
Design prototype board $468 $78 $390
Order Sensors $156 $156
BreadBoard Sensors and connections $546 $234 $312
Outline programming requirements $390 $78 $312
Draft Preliminary Program $1,092 $78 $390 $390 $234
Load program and test $156 $156
Setup "Real" Twitter Account $39 $39
Develop Final Test Criteria $78 $78
Test $780 $78 $390 $312
Put into Case $39 $39
Complete Perm Install $156 $78 $78
Write up Details and Post $234 $234
Week Total $234 $1,326 $1,014 $702 $546 $312
Cumulative $234 $1,560 $2,574 $3,276 $3,822 $4,134
$0.00
$1,250.00
$2,500.00
$3,750.00
$5,000.00
Week 1 Week 2 Week 3 Week 4 Week 5 Week 6
Planned Value at this
time in the project =
$2574
Today

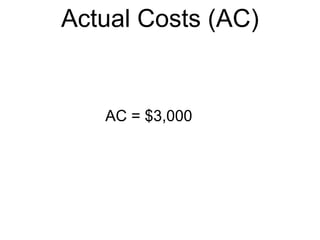

Actual Costs (AC)
AC = $3,000
Percent of work complete
50%
Earned Value
Project Total PV = $4,134
EV= Total PV for Project or Activity
X % Complete
Today = End of Week Three

Percent of work complete
50%
Earned Value
EV= 4,134 X 50% = $2,067
Project Total PV = $4,134
$0.00
$1,250.00
$2,500.00
$3,750.00
$5,000.00

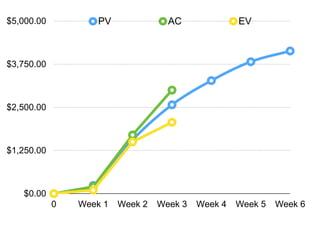

0 Week 1 Week 2 Week 3 Week 4 Week 5 Week 6
PV AC EV
$0.00
$1,250.00
$2,500.00
$3,750.00
$5,000.00
0 Week 1 Week 2 Week 3
PV AC EV

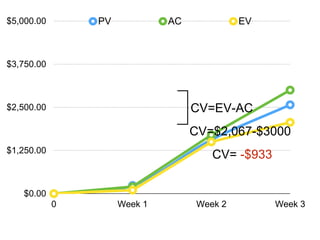

CV=EV-AC
CV=$2,067-$3000
CV= -$933
Indexes to Monitor Progress

Cost Variance (CV) in Project Management

  • 1.
  • 2.
    Earned Value Analysis •Cost Variance • CV = EV - AC • Negative is bad • Positive is good
  • 3.
    Creating a Time-Phased BudgetTask Activity Budget(PV) Week 1 Week 2 Week 3 Week 4 Week 5 Week 6 Design prototype board $468 $78 $390 Order Sensors $156 $156 BreadBoard Sensors and connections $546 $234 $312 Outline programming requirements $390 $78 $312 Draft Preliminary Program $1,092 $78 $390 $390 $234 Load program and test $156 $156 Setup "Real" Twitter Account $39 $39 Develop Final Test Criteria $78 $78 Test $780 $78 $390 $312 Put into Case $39 $39 Complete Perm Install $156 $78 $78 Write up Details and Post $234 $234 Week Total $234 $1,326 $1,014 $702 $546 $312 Cumulative $234 $1,560 $2,574 $3,276 $3,822 $4,134 $0.00 $1,250.00 $2,500.00 $3,750.00 $5,000.00 Week 1 Week 2 Week 3 Week 4 Week 5 Week 6 Planned Value at this time in the project = $2574 Today
  • 4.
  • 5.
    Percent of workcomplete 50% Earned Value Project Total PV = $4,134 EV= Total PV for Project or Activity X % Complete Today = End of Week Three
  • 6.
    Percent of workcomplete 50% Earned Value EV= 4,134 X 50% = $2,067 Project Total PV = $4,134
  • 7.
    $0.00 $1,250.00 $2,500.00 $3,750.00 $5,000.00 0 Week 1Week 2 Week 3 Week 4 Week 5 Week 6 PV AC EV
  • 8.
    $0.00 $1,250.00 $2,500.00 $3,750.00 $5,000.00 0 Week 1Week 2 Week 3 PV AC EV CV=EV-AC CV=$2,067-$3000 CV= -$933
