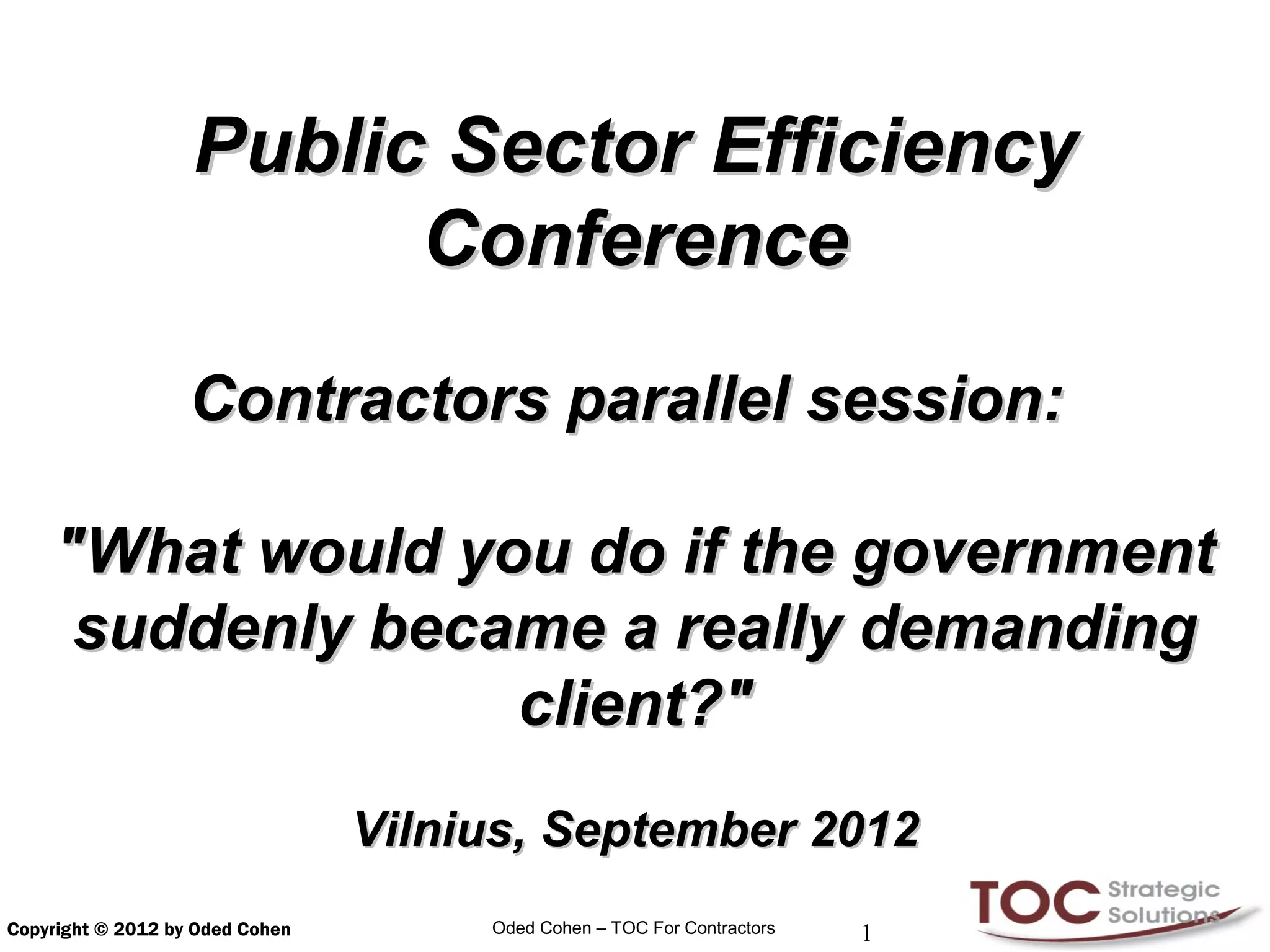

Public Sector Efficiency
                         Conference

                   Contractors parallel session:

    "What would you do if the government
     suddenly became a really demanding
                  client?"
                                 Vilnius, September 2012
Copyright © 2012 by Oded Cohen        Oded Cohen – TOC For Contractors   1

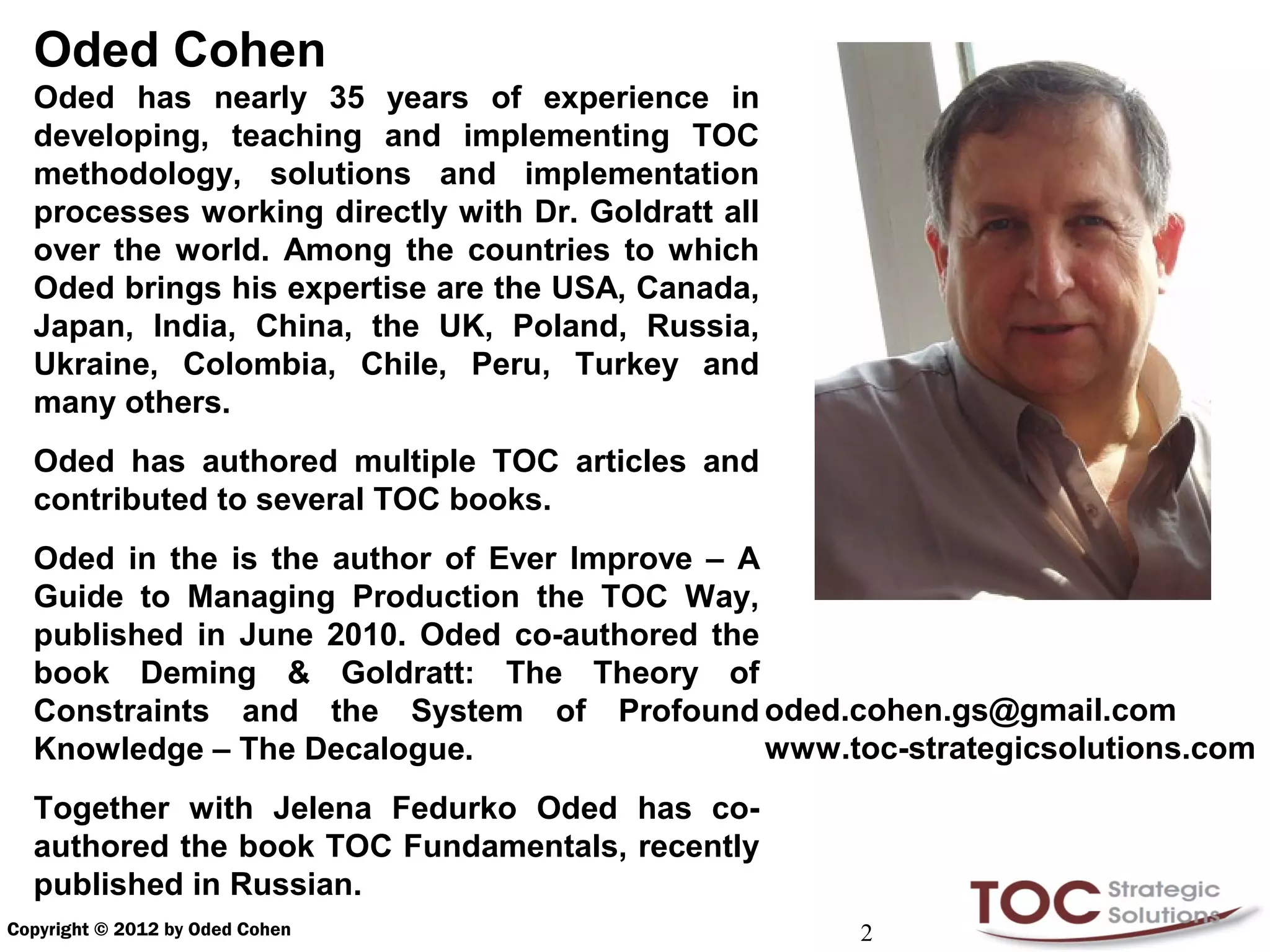

Oded Cohen
  Oded has nearly 35 years of experience in
  developing, teaching and implementing TOC
  methodology, solutions and implementation
  processes working directly with Dr. Goldratt all
  over the world. Among the countries to which
  Oded brings his expertise are the USA, Canada,
  Japan, India, China, the UK, Poland, Russia,
  Ukraine, Colombia, Chile, Peru, Turkey and
  many others.
  Oded has authored multiple TOC articles and
  contributed to several TOC books.
  Oded in the is the author of Ever Improve – A
  Guide to Managing Production the TOC Way,
  published in June 2010. Oded co-authored the
  book Deming & Goldratt: The Theory of
  Constraints and the System of Profound oded.cohen.gs@gmail.com
  Knowledge – The Decalogue.                    www.toc-strategicsolutions.com
  Together with Jelena Fedurko Oded has co-
  authored the book TOC Fundamentals, recently
  published in Russian.
Copyright © 2012 by Oded Cohen                       2

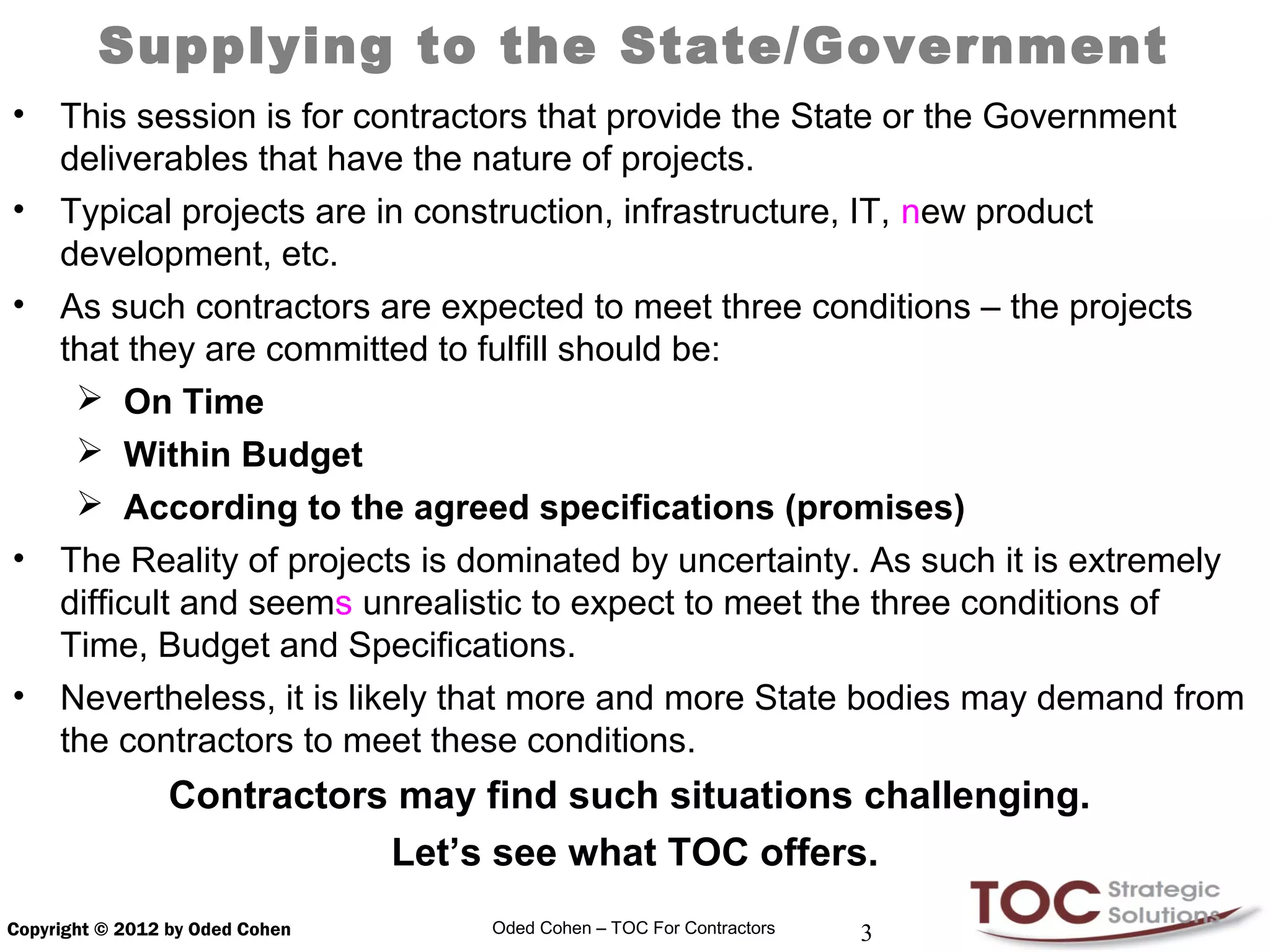

Supplying to the State/Government
•    This session is for contractors that provide the State or the Government
     deliverables that have the nature of projects.
•    Typical projects are in construction, infrastructure, IT, new product
     development, etc.
•    As such contractors are expected to meet three conditions – the projects
     that they are committed to fulfill should be:
       On Time
       Within Budget
       According to the agreed specifications (promises)
•    The Reality of projects is dominated by uncertainty. As such it is extremely
     difficult and seems unrealistic to expect to meet the three conditions of
     Time, Budget and Specifications.
•    Nevertheless, it is likely that more and more State bodies may demand from
     the contractors to meet these conditions.
                 Contractors may find such situations challenging.
                            Let’s see what TOC offers.
Copyright © 2012 by Oded Cohen    Oded Cohen – TOC For Contractors   3

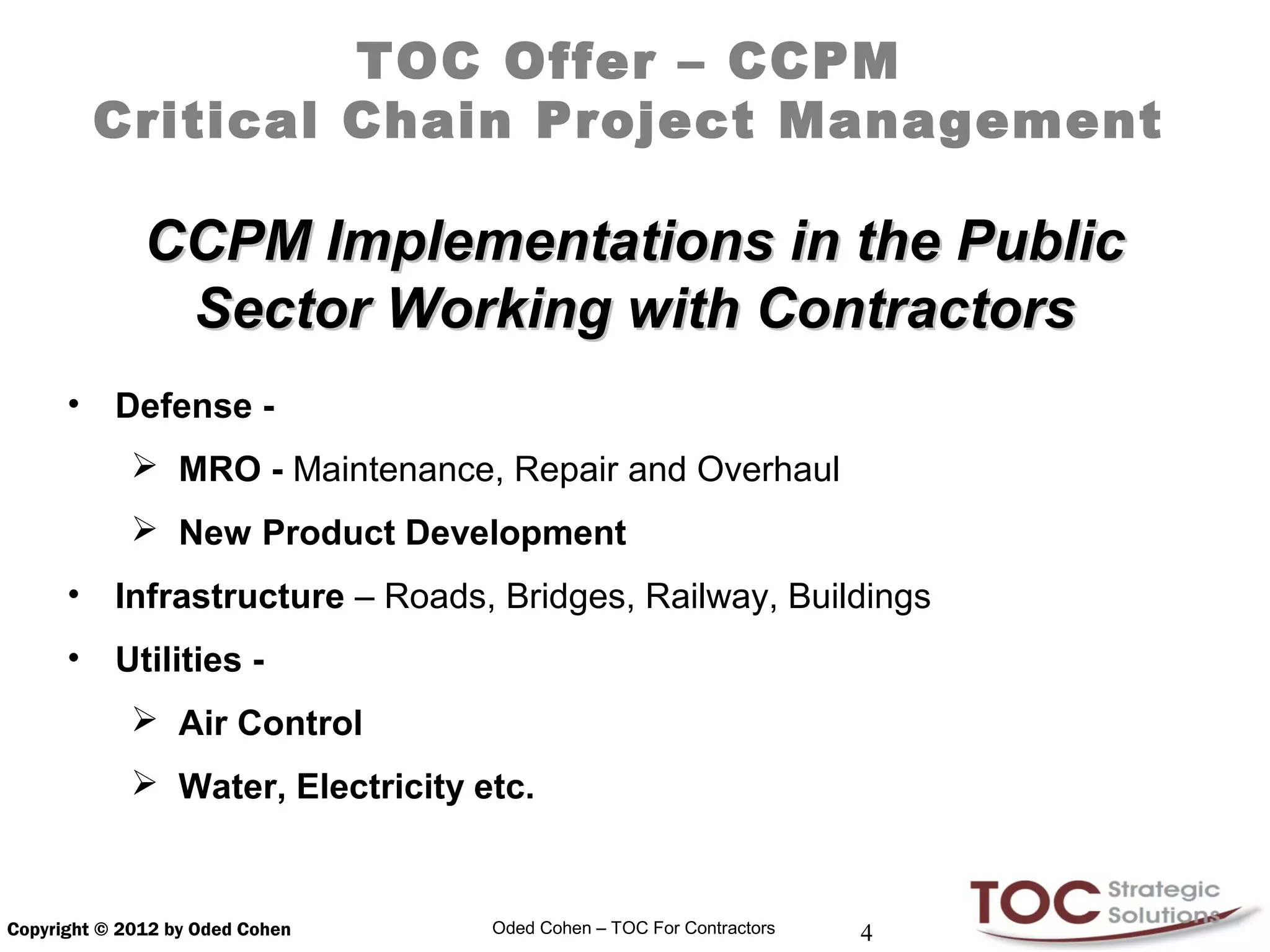

TOC Offer – CCPM
          Critical Chain Project Management

              CCPM Implementations in the Public
               Sector Working with Contractors
      •    Defense -
              MRO - Maintenance, Repair and Overhaul
              New Product Development
      •    Infrastructure – Roads, Bridges, Railway, Buildings
      •    Utilities -
              Air Control
              Water, Electricity etc.

Copyright © 2012 by Oded Cohen     Oded Cohen – TOC For Contractors   4
Copyright © 2012 by Oded Cohen   5

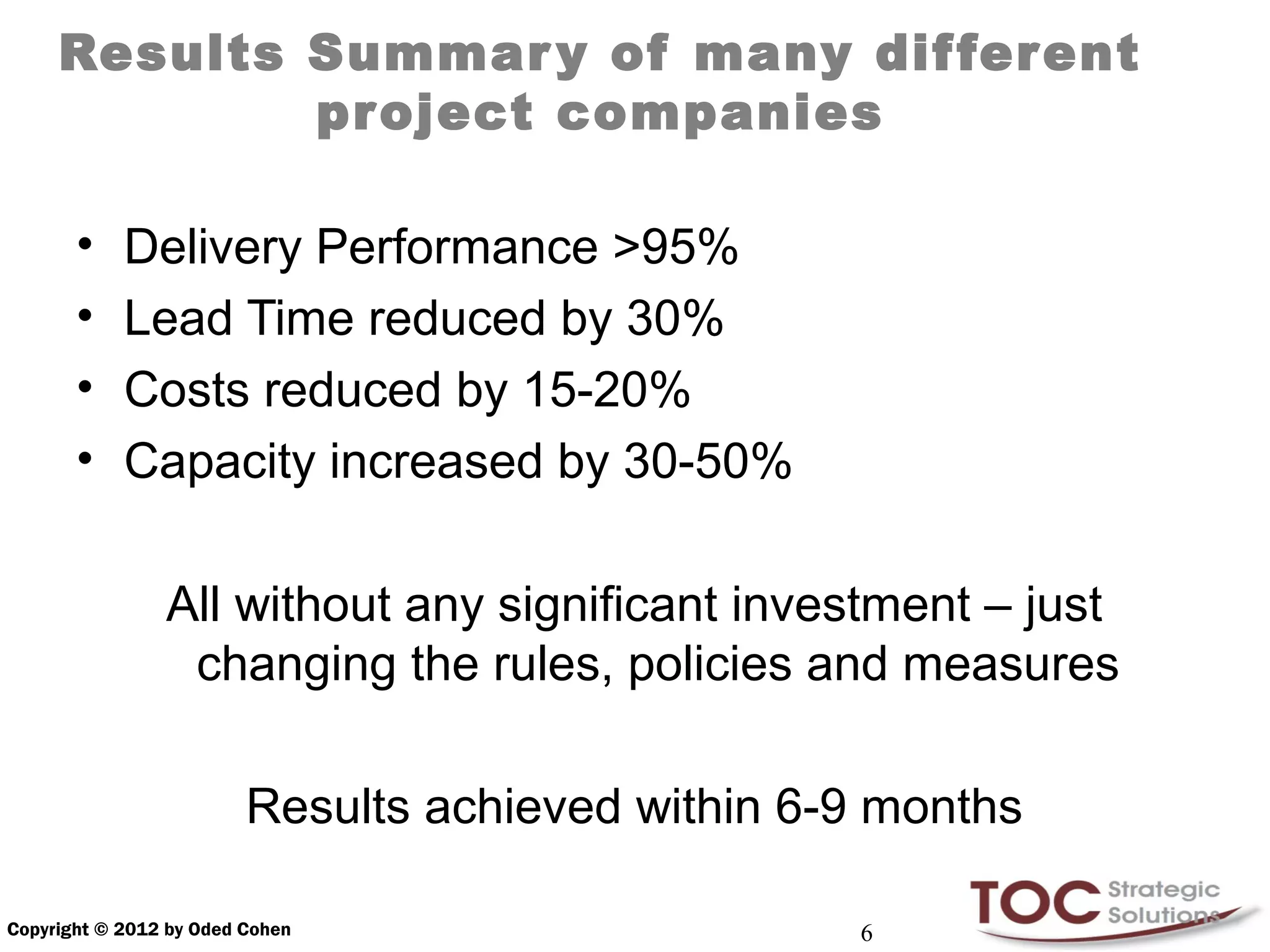

Results Summar y of many dif ferent
             project companies

       •    Delivery Performance >95%
       •    Lead Time reduced by 30%
       •    Costs reduced by 15-20%
       •    Capacity increased by 30-50%

                All without any significant investment – just
                 changing the rules, policies and measures

                         Results achieved within 6-9 months

Copyright © 2012 by Oded Cohen                     6

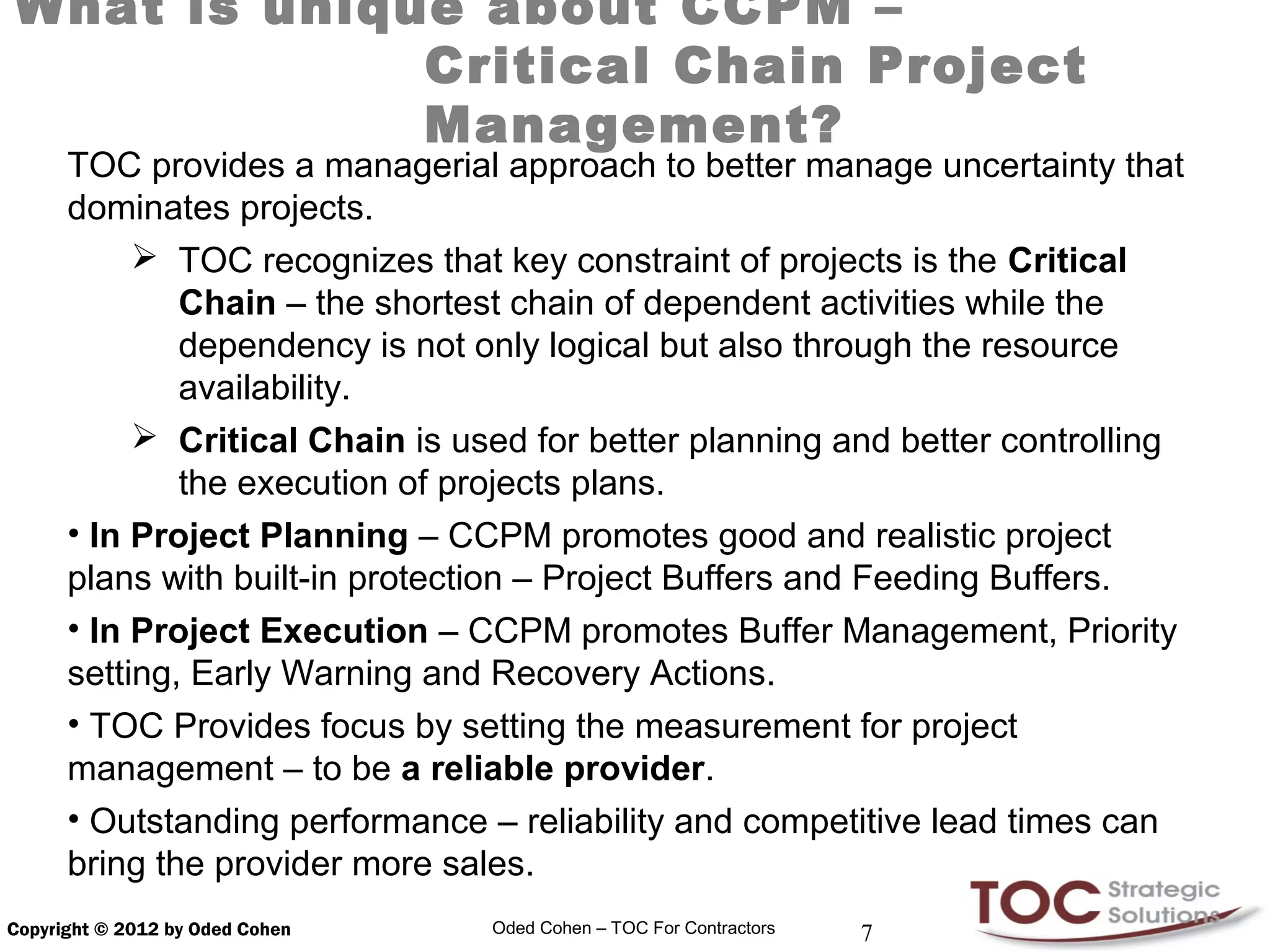

What is unique about CCPM –
             Critical Chain Project
             Management?
      TOC provides a managerial approach to better manage uncertainty that
      dominates projects.
            TOC recognizes that key constraint of projects is the Critical
              Chain – the shortest chain of dependent activities while the
              dependency is not only logical but also through the resource
              availability.
            Critical Chain is used for better planning and better controlling
              the execution of projects plans.
      • In Project Planning – CCPM promotes good and realistic project
      plans with built-in protection – Project Buffers and Feeding Buffers.
      • In Project Execution – CCPM promotes Buffer Management, Priority
      setting, Early Warning and Recovery Actions.
      • TOC Provides focus by setting the measurement for project
      management – to be a reliable provider.
      • Outstanding performance – reliability and competitive lead times can
      bring the provider more sales.
Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   7

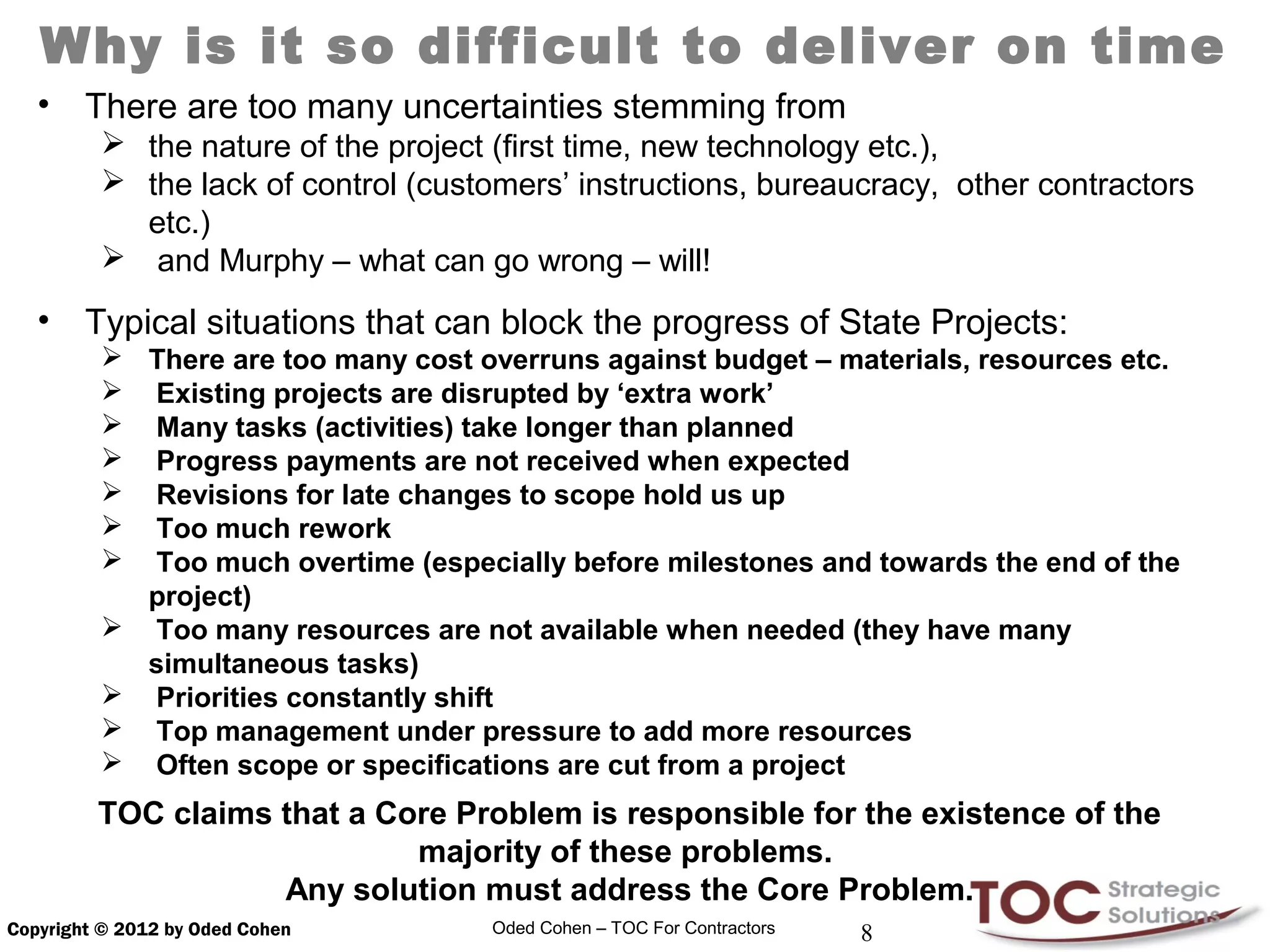

Why is it so difficult to deliver on time
   •    There are too many uncertainties stemming from
          the nature of the project (first time, new technology etc.),
          the lack of control (customers’ instructions, bureaucracy, other contractors
           etc.)
          and Murphy – what can go wrong – will!

   •    Typical situations that can block the progress of State Projects:
          There are too many cost overruns against budget – materials, resources etc.
          Existing projects are disrupted by ‘extra work’
          Many tasks (activities) take longer than planned
          Progress payments are not received when expected
          Revisions for late changes to scope hold us up
          Too much rework
          Too much overtime (especially before milestones and towards the end of the
           project)
          Too many resources are not available when needed (they have many
           simultaneous tasks)
          Priorities constantly shift
          Top management under pressure to add more resources
          Often scope or specifications are cut from a project
         TOC claims that a Core Problem is responsible for the existence of the
                             majority of these problems.
                    Any solution must address the Core Problem.
Copyright © 2012 by Oded Cohen      Oded Cohen – TOC For Contractors   8

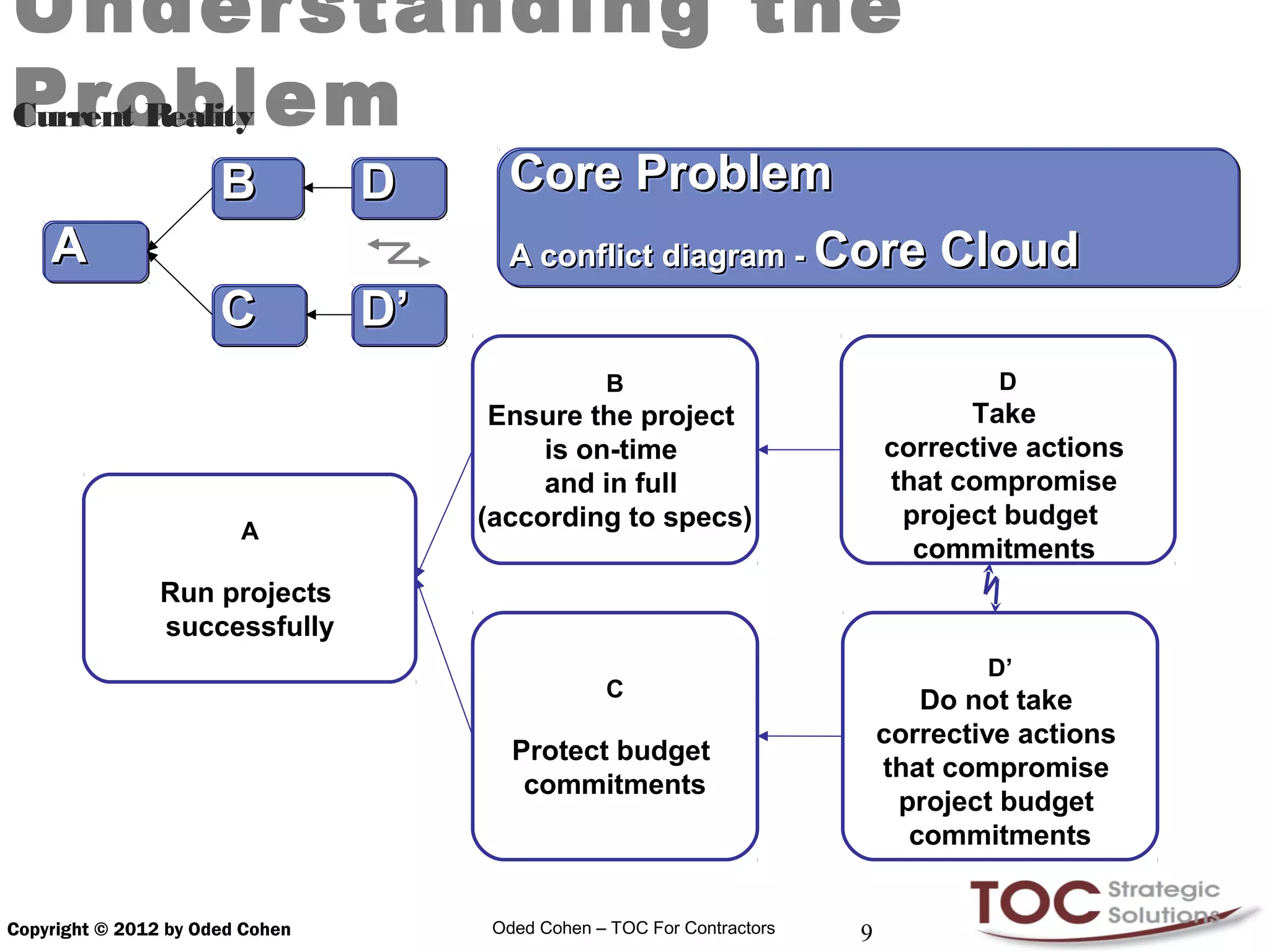

Understanding the
Problem
Current Reality

                      B          D      Core Problem
    A                                   A conflict diagram - Core Cloud
                      C          D’
                                                   B                                   D
                                       Ensure the project                           Take
                                           is on-time                         corrective actions
                                           and in full                        that compromise
                                      (according to specs)                     project budget
                        A
                                                                                commitments
                Run projects
                successfully
                                                                                      D’
                                                   C                             Do not take
                                                                              corrective actions
                                         Protect budget
                                                                              that compromise
                                          commitments
                                                                               project budget
                                                                                commitments

Copyright © 2012 by Oded Cohen         Oded Cohen – TOC For Contractors   9

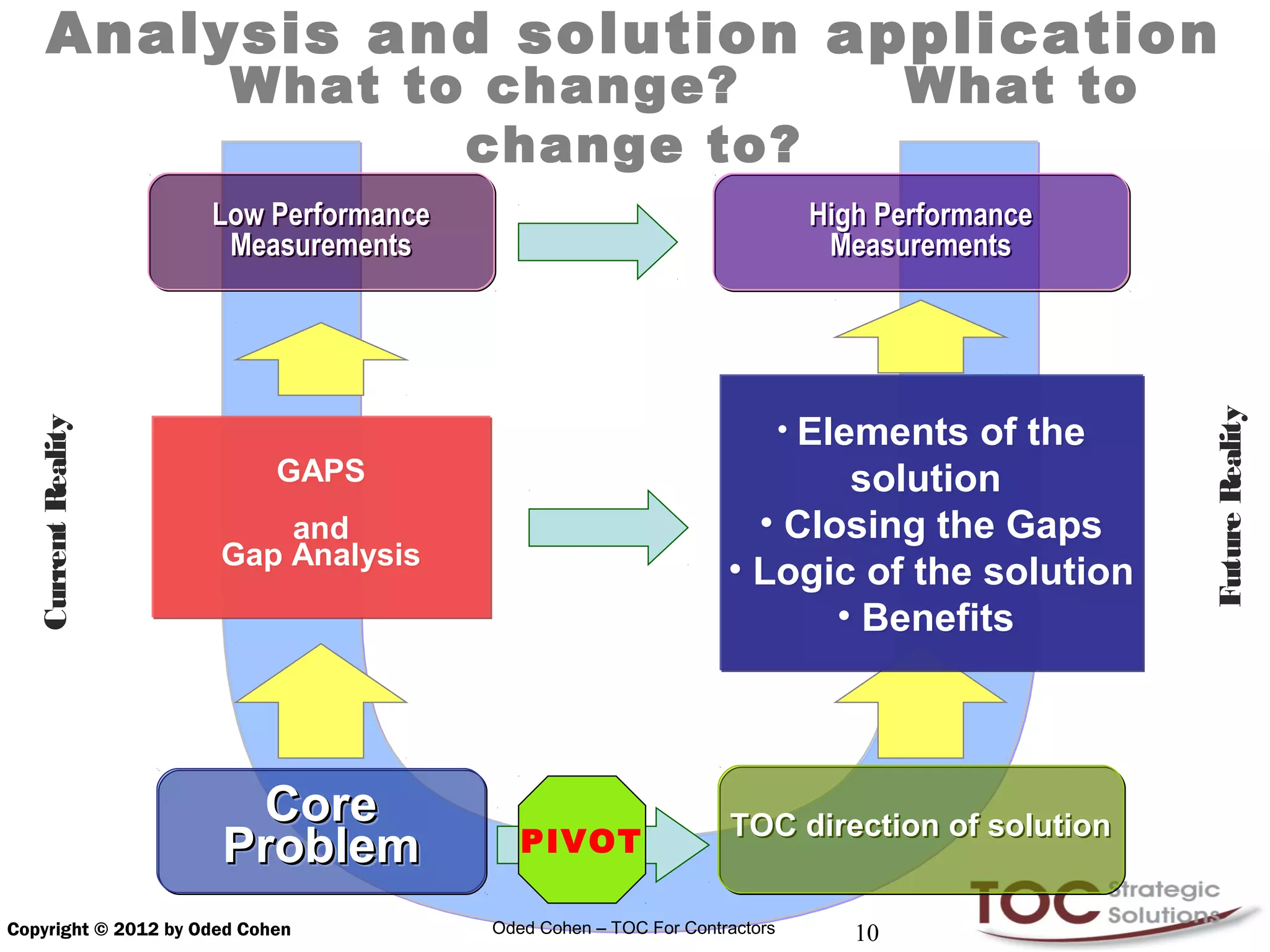

Analysis and solution application
                       What to change?                                             What to
                              change to?
                     Low Performance                                       High Performance
                      Measurements                                          Measurements

                                                                                              Future Reality
                                                                          • Elements of the
   Current Reality

                            GAPS                                         solution
                          and                                      • Closing the Gaps
                      Gap Analysis
                                                                 • Logic of the solution
                                                                        • Benefits

                       Core                                      TOC direction of solution
                      Problem             PIVOT

Copyright © 2012 by Oded Cohen         Oded Cohen – TOC For Contractors       10

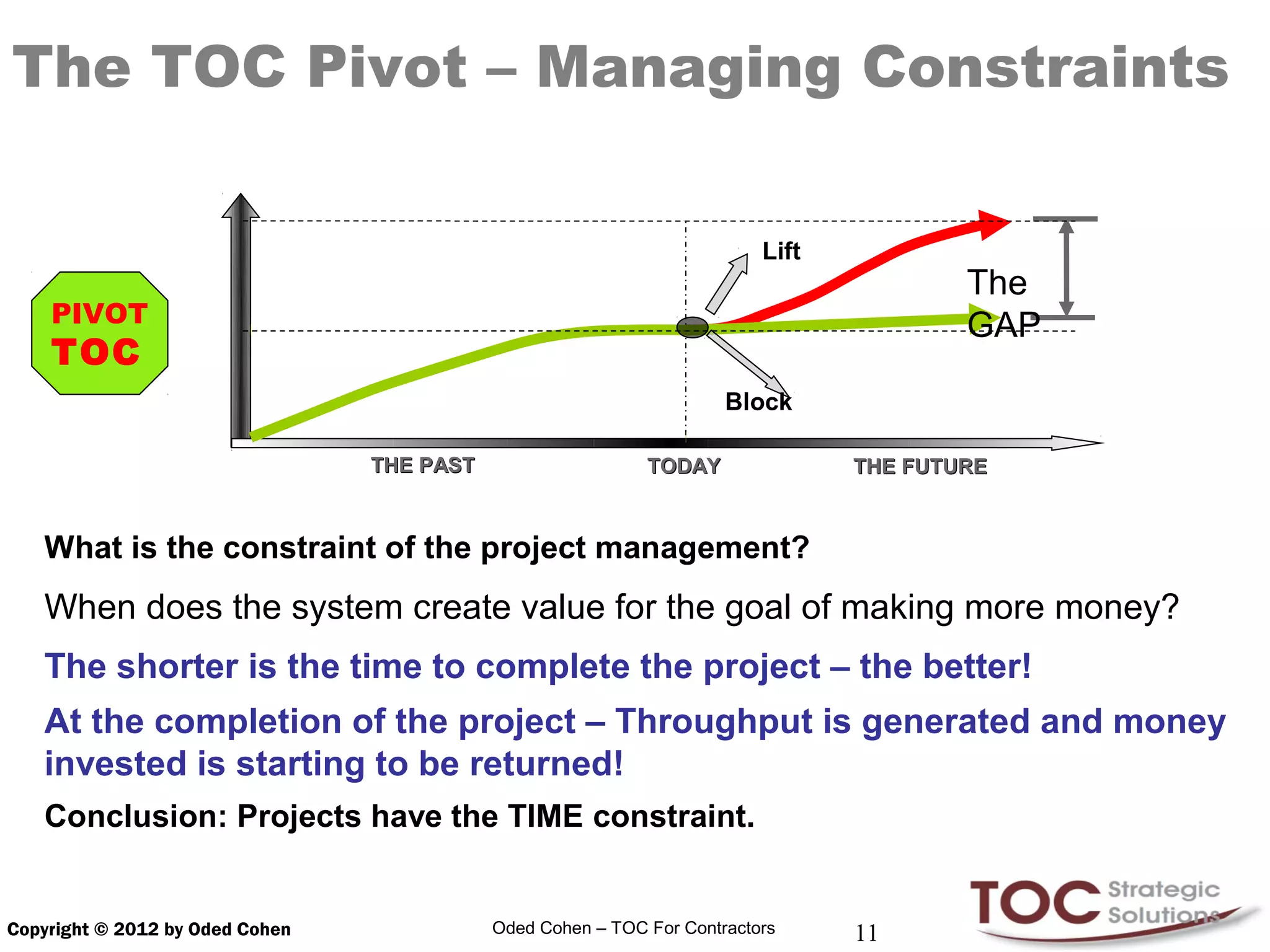

The TOC Pivot – Managing Constraints

                                                                          Lift
                                                                                         The
    PIVOT                                                                                GAP
    TOC
                                                                      Block

                                 THE PAST                    TODAY               THE FUTURE

   What is the constraint of the project management?
   When does the system create value for the goal of making more money?
   The shorter is the time to complete the project – the better!
   At the completion of the project – Throughput is generated and money
   invested is starting to be returned!
   Conclusion: Projects have the TIME constraint.

Copyright © 2012 by Oded Cohen              Oded Cohen – TOC For Contractors     11

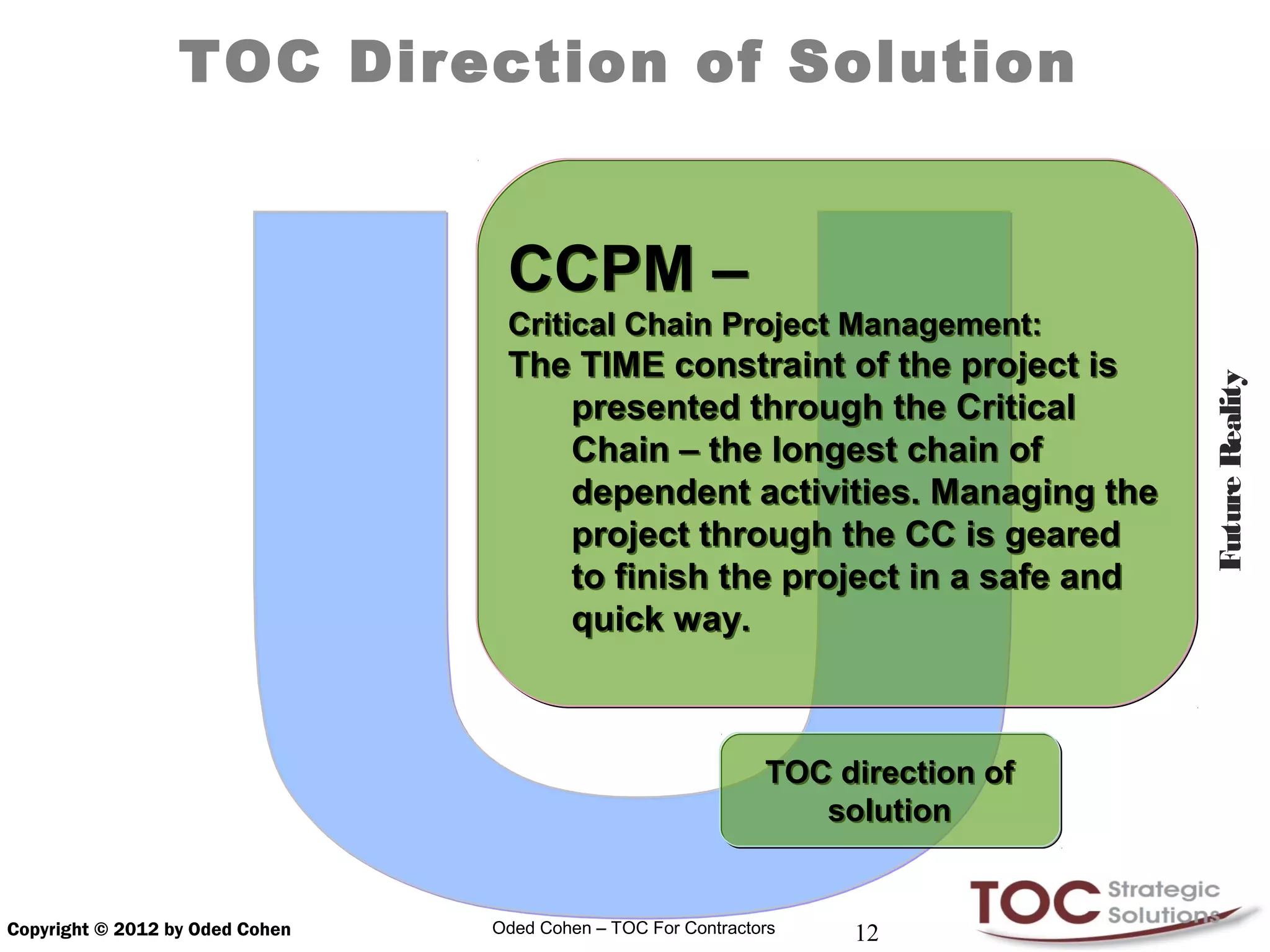

TOC Direction of Solution

                                  CCPM –
                                  Critical Chain Project Management:
                                  The TIME constraint of the project is

                                                                                  Future Reality
                                     presented through the Critical
                                     Chain – the longest chain of
                                     dependent activities. Managing the
                                     project through the CC is geared
                                     to finish the project in a safe and
                                     quick way.

                                                               TOC direction of
                                                                  solution

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   12

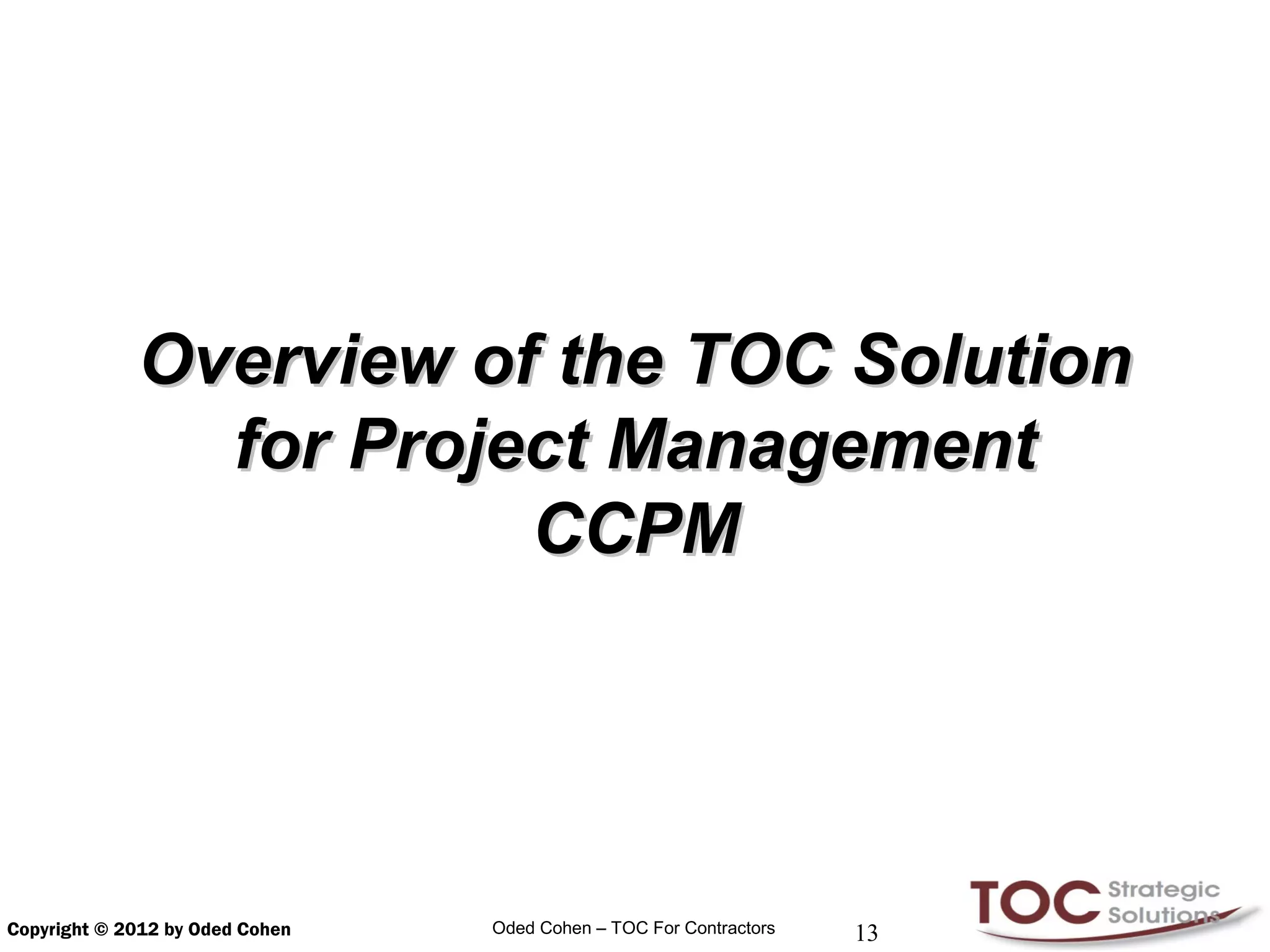

Overview of the TOC Solution
               for Project Management
                        CCPM

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   13

TOC Solution for Single Project
                       Management
                                           Strategy:
                        The Project is On Time, In Full & Within Budget

                                       Tactics:
        The Project organization implements Critical Chain project management

                 Mindset:

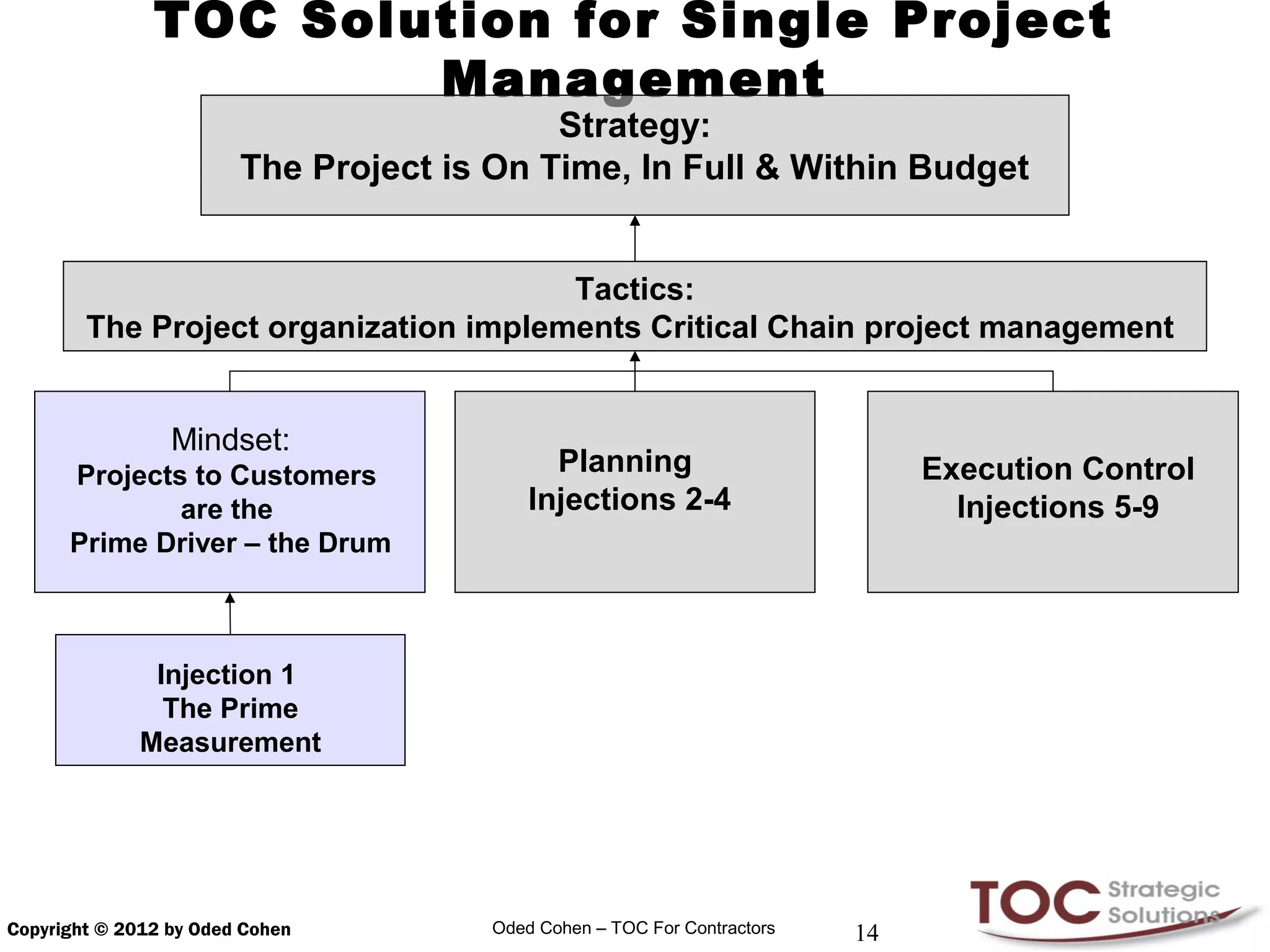

      Projects to Customers                  Planning                          Execution Control
              are the                      Injections 2-4                        Injections 5-9
      Prime Driver – the Drum

               Injection 1
                The Prime
              Measurement

Copyright © 2012 by Oded Cohen         Oded Cohen – TOC For Contractors   14
CCPM – Injection 1
                     Achievement of the delivery
                  commitments is established as a
                  Prime Measurement for managing
                        project environment

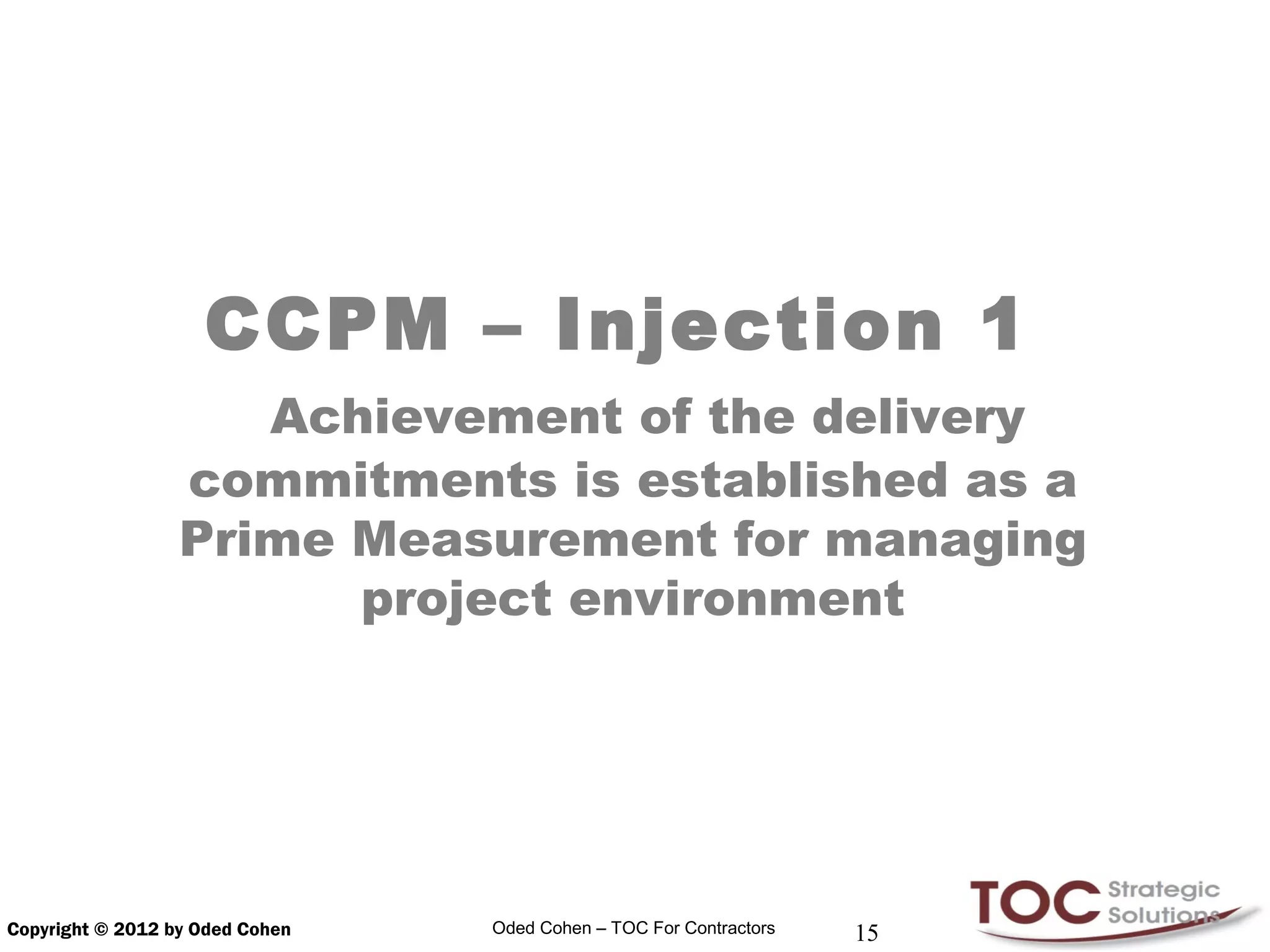

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   15

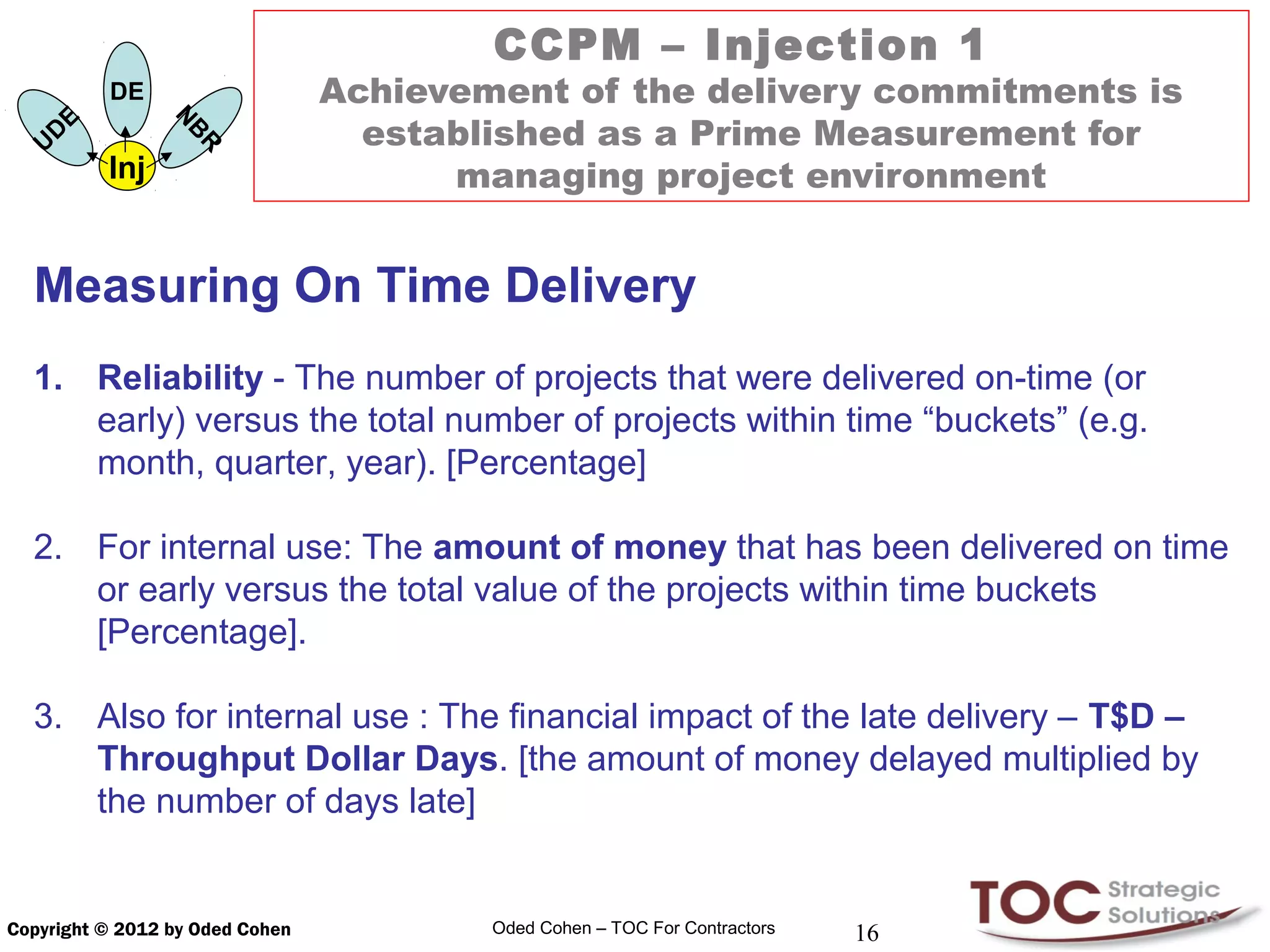

CCPM – Injection 1
               DE                Achievement of the delivery commitments is
           E
                                   established as a Prime Measurement for
                     N
       D
                     B
   U
                     R                 managing project environment
               Inj

  Measuring On Time Delivery
  1. Reliability - The number of projects that were delivered on-time (or
     early) versus the total number of projects within time “buckets” (e.g.
     month, quarter, year). [Percentage]

  2. For internal use: The amount of money that has been delivered on time
     or early versus the total value of the projects within time buckets
     [Percentage].

  3. Also for internal use : The financial impact of the late delivery – T$D –
     Throughput Dollar Days. [the amount of money delayed multiplied by
     the number of days late]

Copyright © 2012 by Oded Cohen           Oded Cohen – TOC For Contractors   16

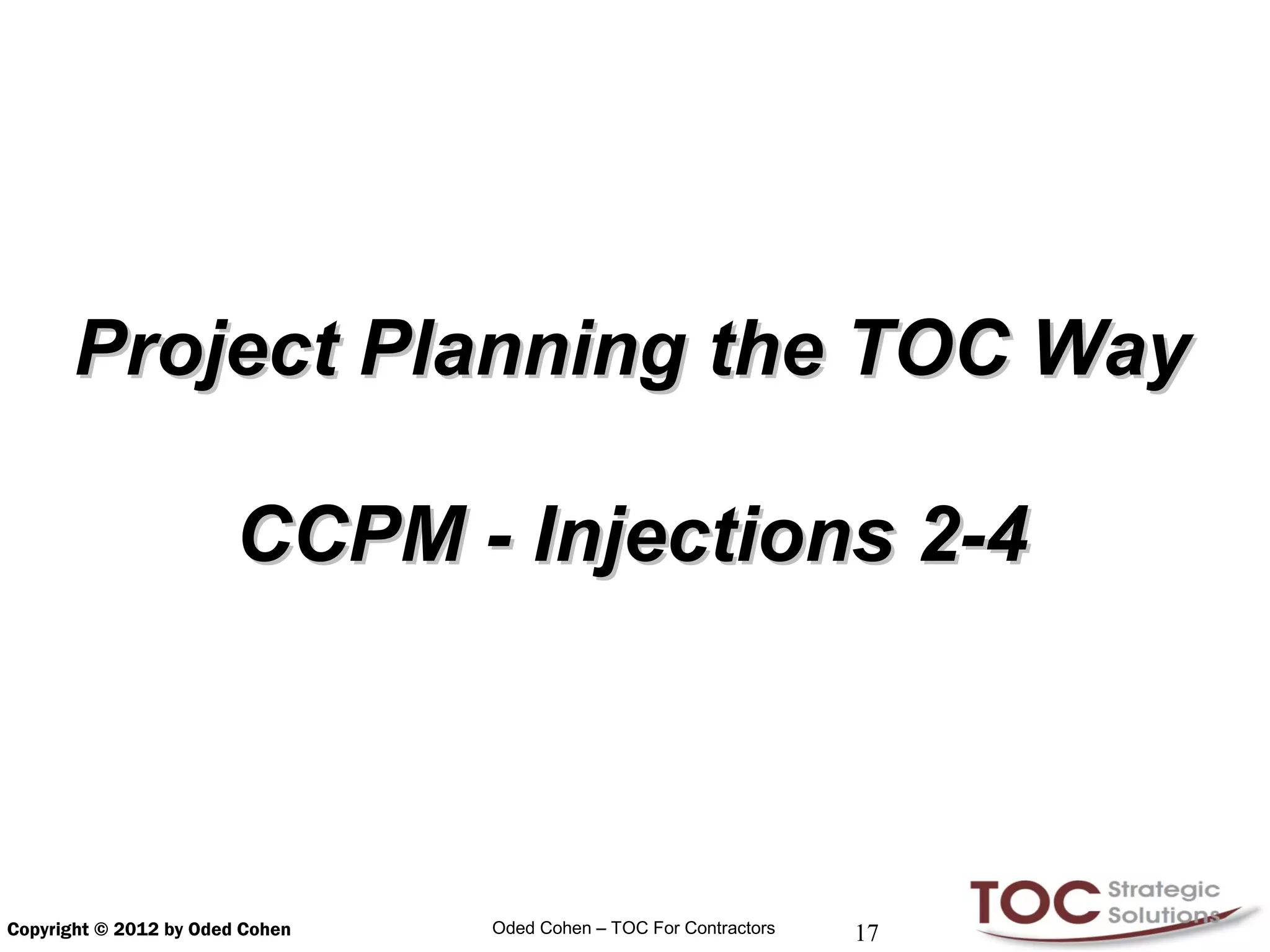

Project Planning the TOC Way

                        CCPM - Injections 2-4

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   17
TOC Solution for Single Project
                       Management
                                       Tactics:
        The Project organization implements Critical Chain project management

                  Mindset:

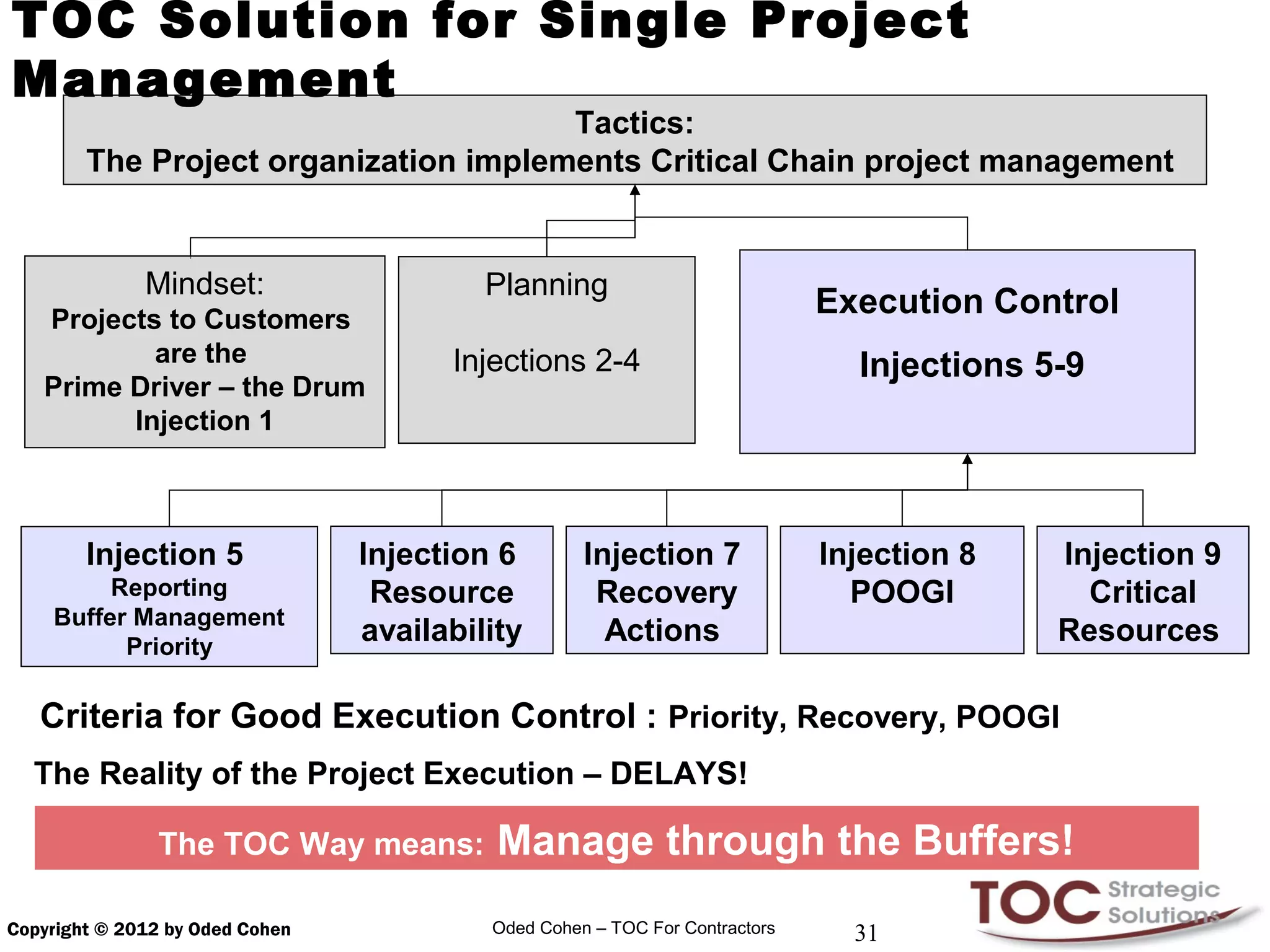

       Projects to Customers                        Planning                        Execution
               are the                            Injections 2-4                     Control
       Prime Driver – the Drum                                                    Injections 5-9
             Injection 1

                 Injection 2                       Injection 3                       Injection 4
               Project Planning                   Critical Chain
                  Diagrams                             Plan                            Buffers

                                 Criteria for a Good Project Plan:
                                       • Provide Financial Benefits
                                                • Realistic
                                    • Immunized against Disruptions

Copyright © 2012 by Oded Cohen            Oded Cohen – TOC For Contractors   18

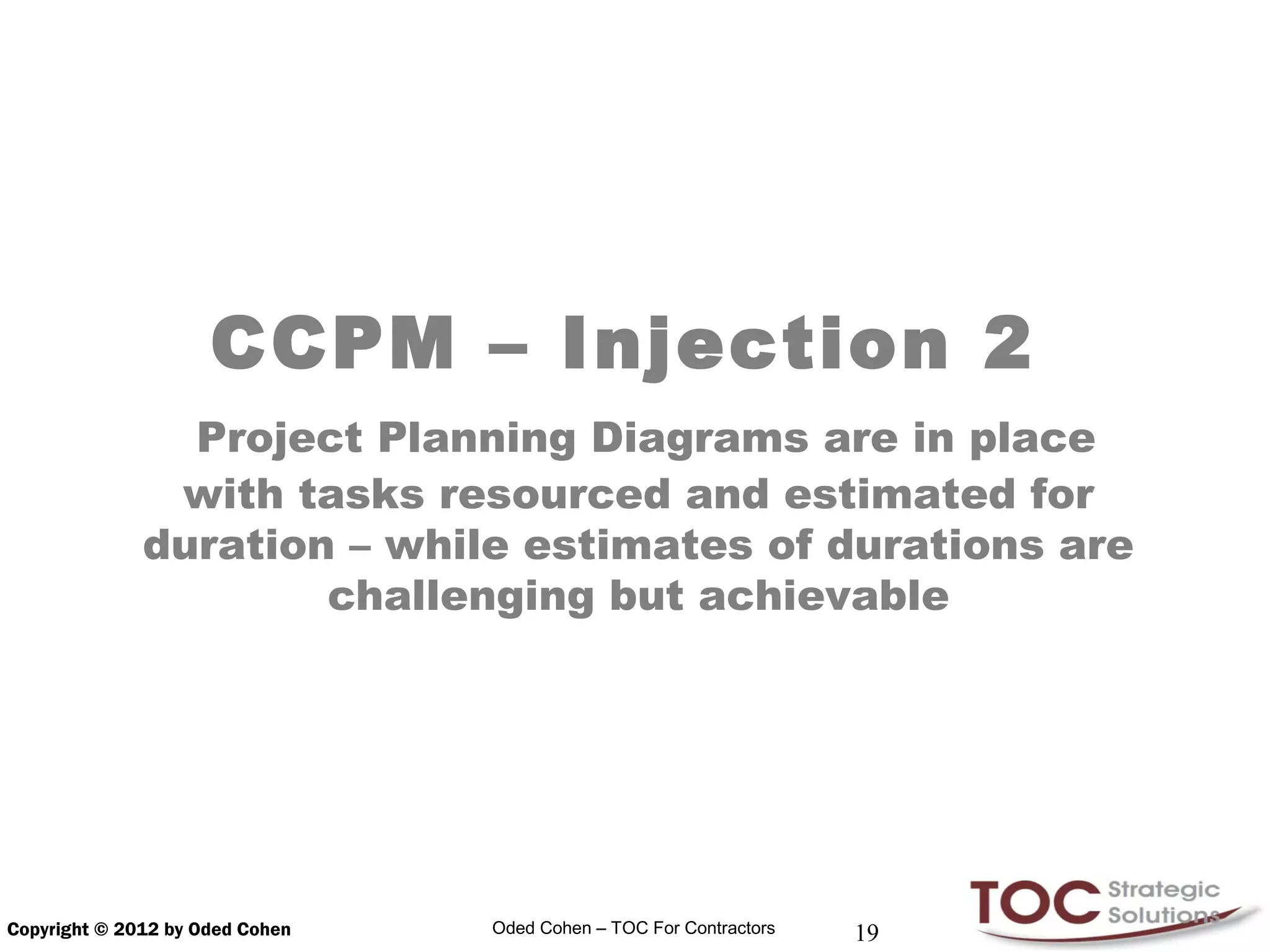

CCPM – Injection 2
                Project Planning Diagrams are in place
               with tasks resourced and estimated for
              duration – while estimates of durations are
                      challenging but achievable

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   19

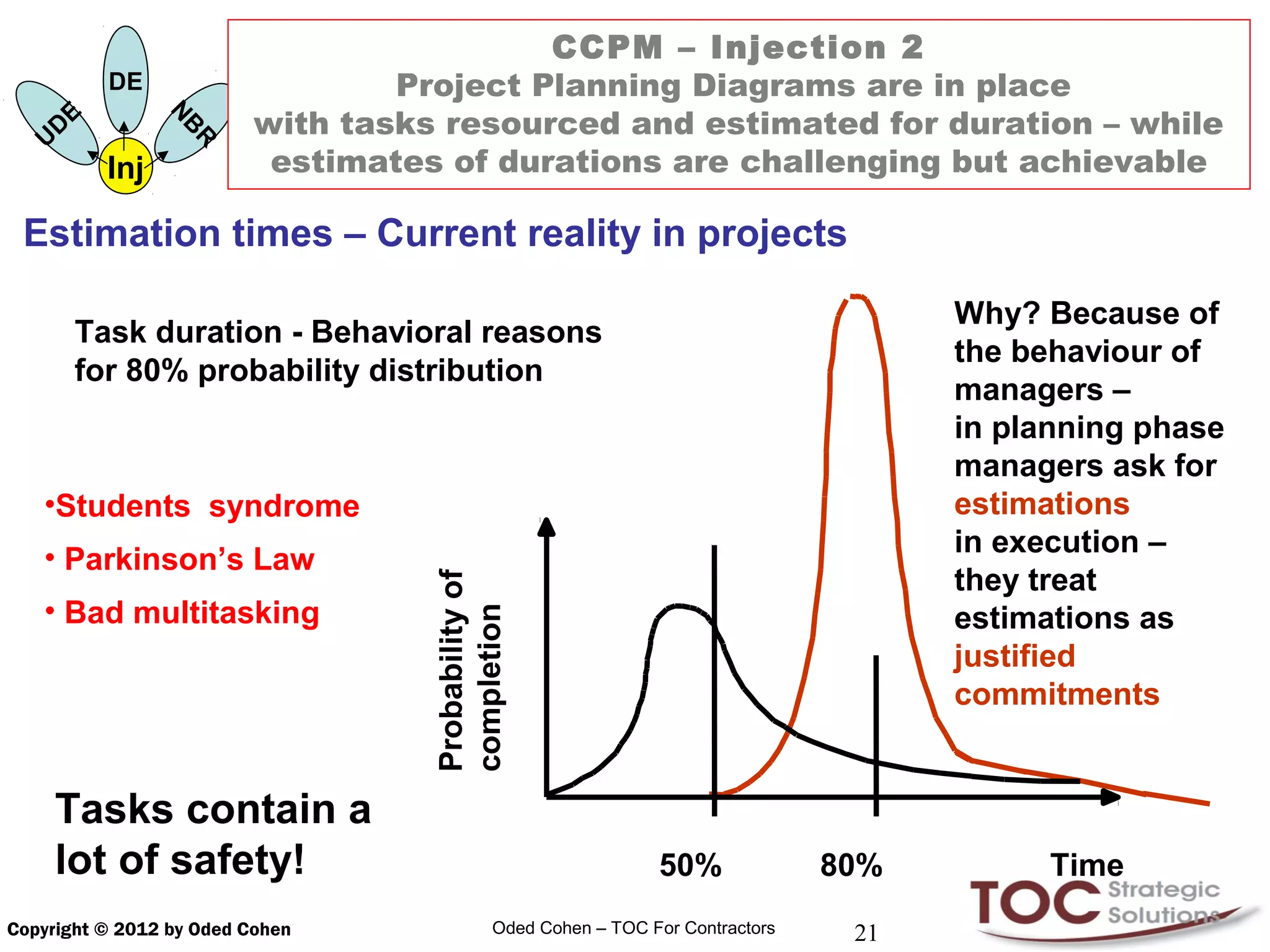

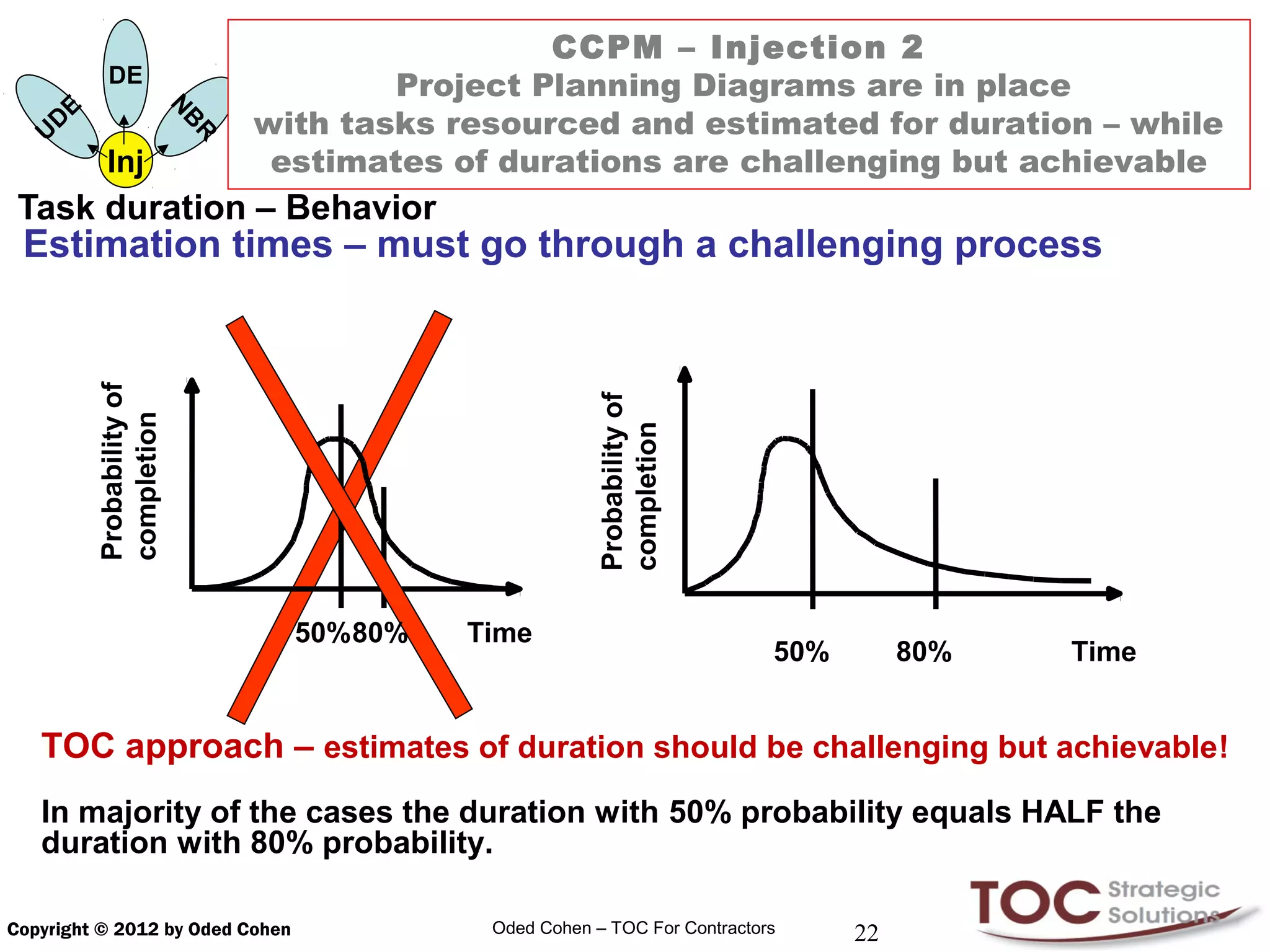

CCPM – Injection 2
               DE
           E                        Project Planning Diagrams are in place
                     N
       D
                            with tasks resourced and estimated for duration – while
                     B
   U
               Inj   R       estimates of durations are challenging but achievable

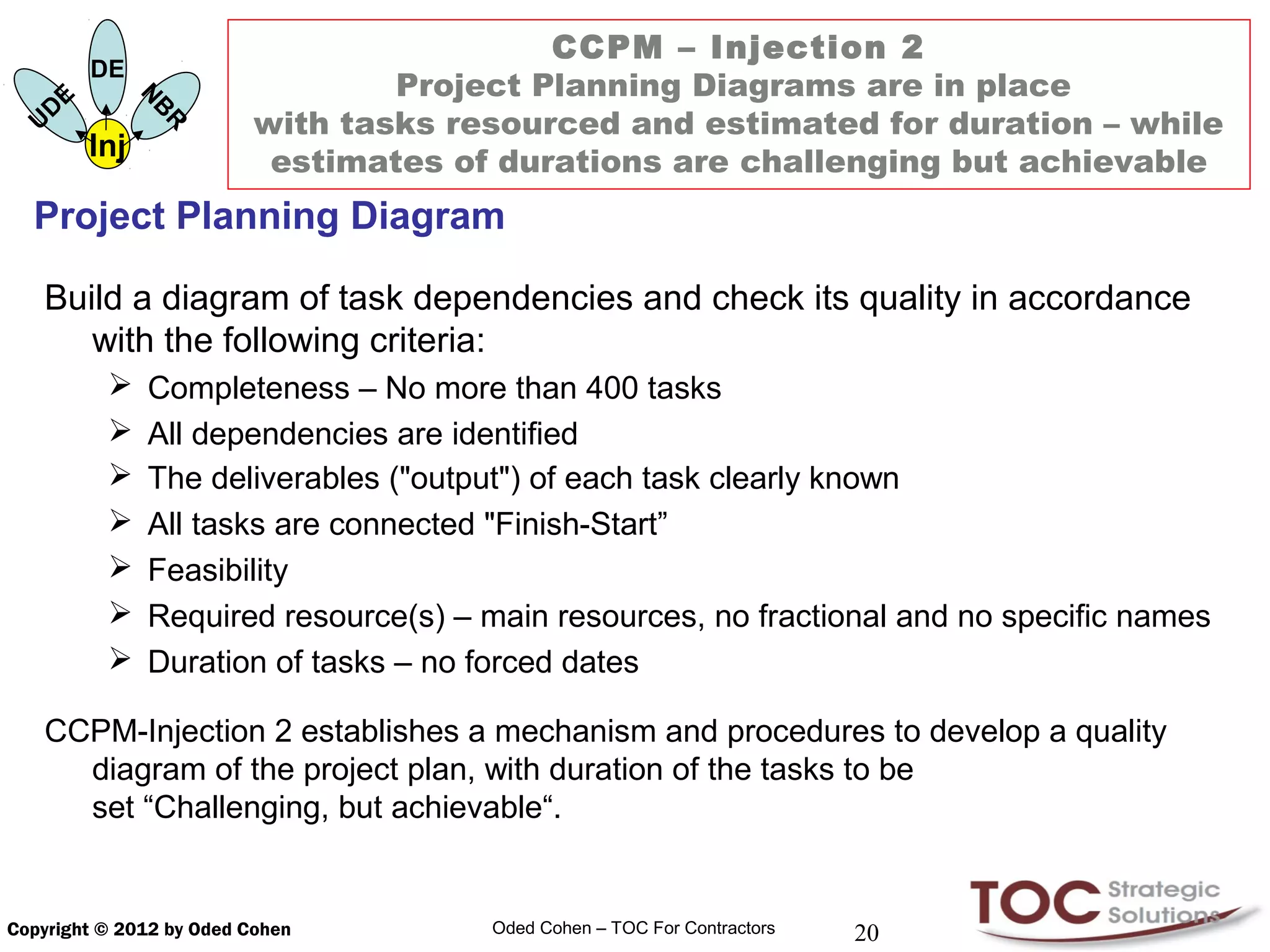

  Project Planning Diagram

   Build a diagram of task dependencies and check its quality in accordance
      with the following criteria:
                    Completeness – No more than 400 tasks
                    All dependencies are identified
                    The deliverables ("output") of each task clearly known
                    All tasks are connected "Finish-Start”
                    Feasibility
                    Required resource(s) – main resources, no fractional and no specific names
                    Duration of tasks – no forced dates

   CCPM-Injection 2 establishes a mechanism and procedures to develop a quality
     diagram of the project plan, with duration of the tasks to be
     set “Challenging, but achievable“.

Copyright © 2012 by Oded Cohen              Oded Cohen – TOC For Contractors   20
CCPM – Injection 2
                DE                Project Planning Diagrams are in place
            E             with tasks resourced and estimated for duration – while
                      N
        D
                      B
    U
                      R
                Inj        estimates of durations are challenging but achievable

 Estimation times – Current reality in projects

                                                                                        Why? Because of
            Task duration - Behavioral reasons
                                                                                        the behaviour of
            for 80% probability distribution
                                                                                        managers –
                                                                                        in planning phase
                                                                                        managers ask for
   •Students syndrome                                                                   estimations
                                                                                        in execution –
   • Parkinson’s Law
                                                                                        they treat
                                    Probability of

   • Bad multitasking                                                                   estimations as
                                    completion

                                                                                        justified
                                                                                        commitments

     Tasks contain a
     lot of safety!                                              50%              80%         Time
Copyright © 2012 by Oded Cohen                 Oded Cohen – TOC For Contractors    21
CCPM – Injection 2
                  DE
                                             Project Planning Diagrams are in place
            E
                                     with tasks resourced and estimated for duration – while
                                 N
        D

                                 B
    U

                                 R
                  Inj                 estimates of durations are challenging but achievable
 Task duration – Behavior
 Estimation times – must go through a challenging process
                Probability of

                                                             Probability of
                completion

                                       50%80%    Time        completion          50%        80%   Time

   TOC approach – estimates of duration should be challenging but achievable!
   In majority of the cases the duration with 50% probability equals HALF the
   duration with 80% probability.

Copyright © 2012 by Oded Cohen                    Oded Cohen – TOC For Contractors     22
CCPM – Injection 3
                   Critical Chain determined through
                    resolving resource contention

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   23
DE                          CCPM – Injection 3
            E                    Critical Chain determined through resolving
                      N
        D

                      B
    U
                                             resource contention
                      R
                Inj

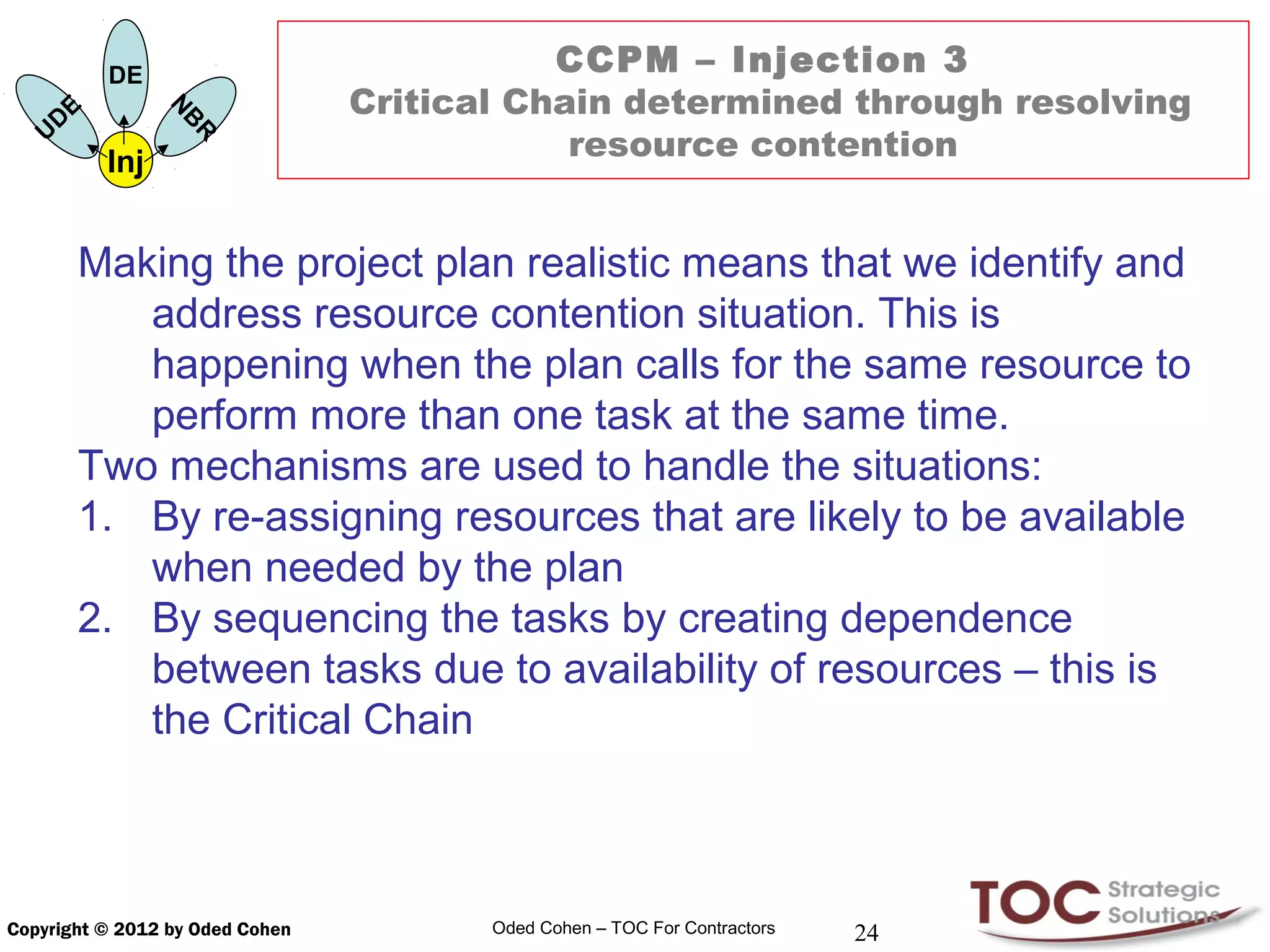

            Making the project plan realistic means that we identify and
               address resource contention situation. This is
               happening when the plan calls for the same resource to
               perform more than one task at the same time.
            Two mechanisms are used to handle the situations:
            1. By re-assigning resources that are likely to be available
               when needed by the plan
            2. By sequencing the tasks by creating dependence
               between tasks due to availability of resources – this is
               the Critical Chain

Copyright © 2012 by Oded Cohen          Oded Cohen – TOC For Contractors   24
DE                           CCPM – Injection 3
            E                     Critical Chain determined through resolving
                      N
        D

                      B
    U
                                              resource contention
                      R
                Inj

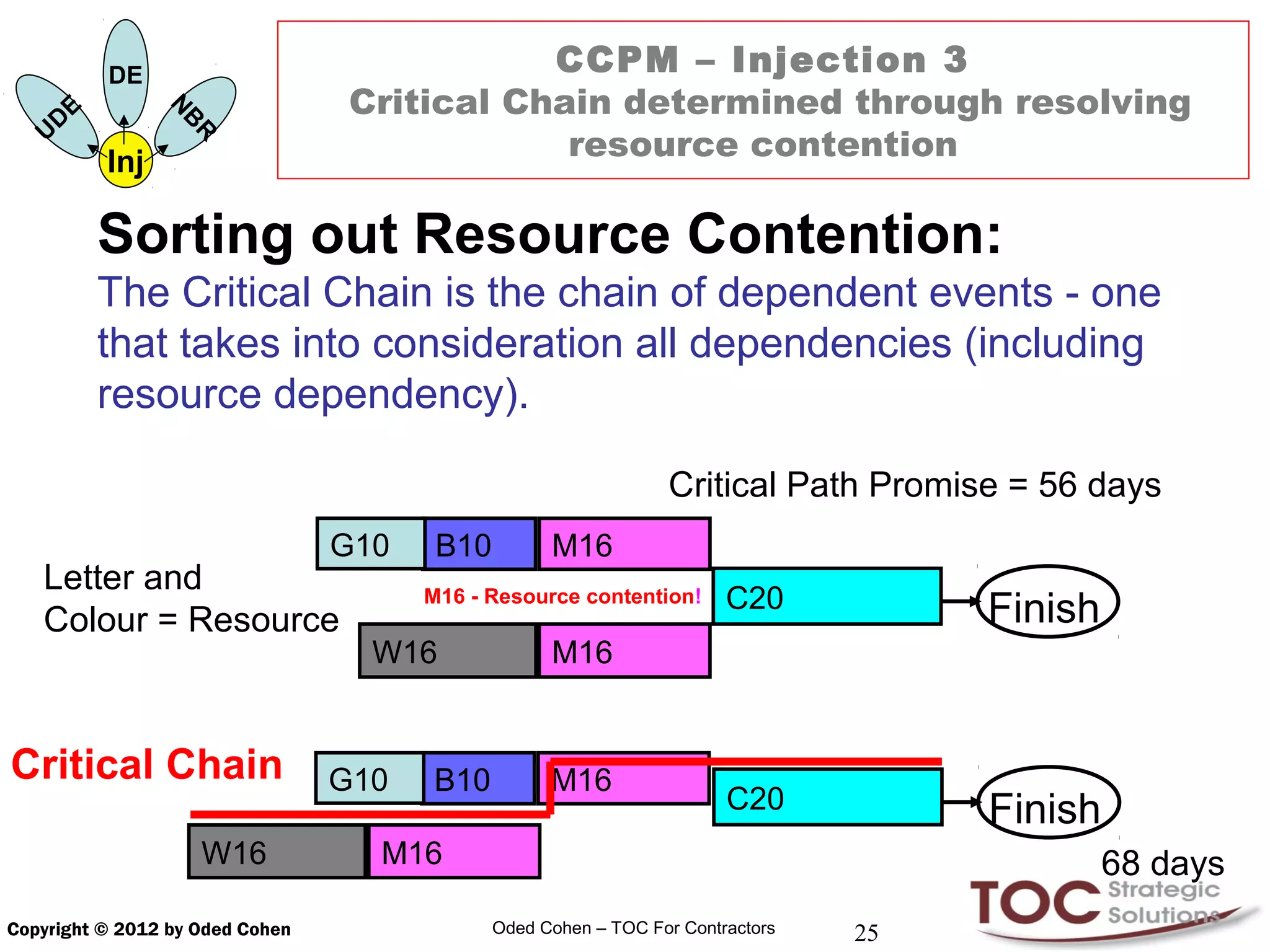

                Sorting out Resource Contention:
                The Critical Chain is the chain of dependent events - one
                that takes into consideration all dependencies (including
                resource dependency).

                                                                 Critical Path Promise = 56 days
                                 G10    B10         M16
   Letter and                          M16 - Resource contention!       C20           Finish
   Colour = Resource
                                   W16              M16

Critical Chain                   G10   B10          M16
                                                                        C20           Finish
                          W16      M16                                                         68 days
Copyright © 2012 by Oded Cohen                Oded Cohen – TOC For Contractors   25
DE                          CCPM – Injection 3
            E                    Critical Chain determined through resolving
                      N
        D

                      B
    U
                                             resource contention
                      R
                Inj

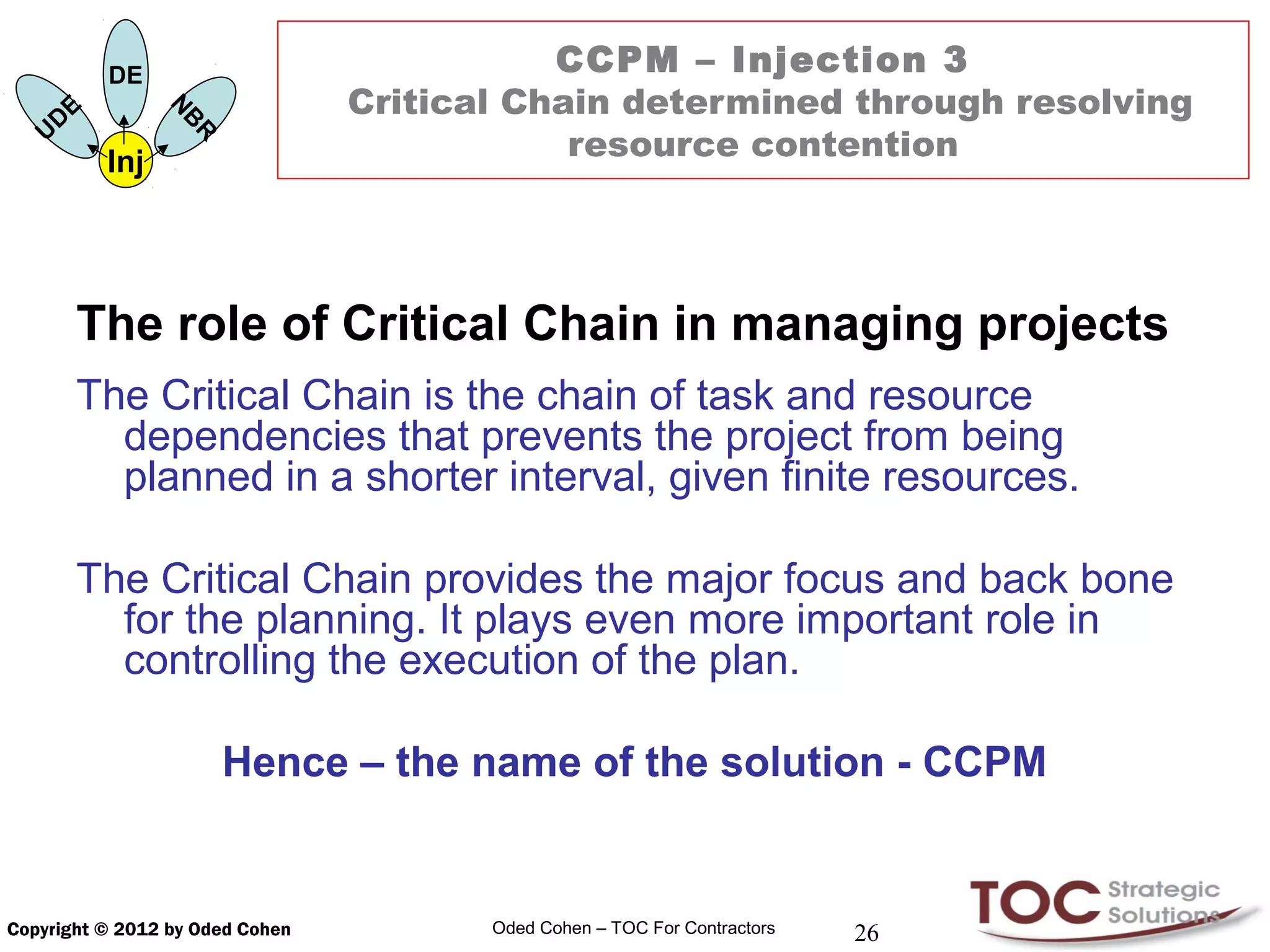

            The role of Critical Chain in managing projects
            The Critical Chain is the chain of task and resource
              dependencies that prevents the project from being
              planned in a shorter interval, given finite resources.

            The Critical Chain provides the major focus and back bone
              for the planning. It plays even more important role in
              controlling the execution of the plan.

                          Hence – the name of the solution - CCPM

Copyright © 2012 by Oded Cohen          Oded Cohen – TOC For Contractors   26
CCPM – Injection 4
               Buffers are inserted in strategic
                            points

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   27
E
                DE                         CCPM – Injection 4

                      N
        D
                                 Buffers are inserted in strategic points
                      B
    U

                      R
                Inj

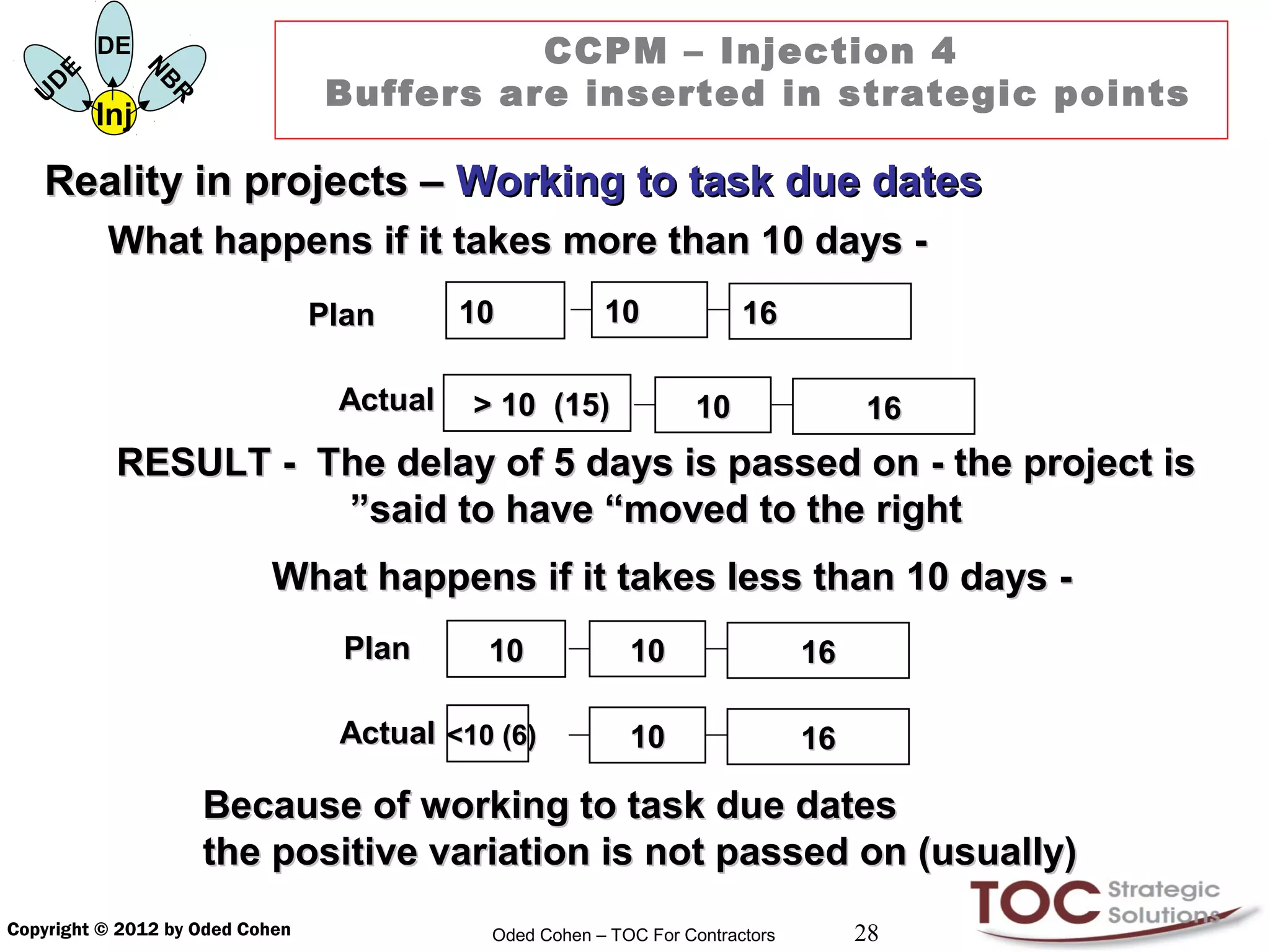

   Reality in projects – Working to task due dates
                What happens if it takes more than 10 days -
                                 Plan      10           10              16

                                  Actual   > 10 (15)              10                16
                 RESULT - The delay of 5 days is passed on - the project is
                           ”said to have “moved to the right
                             What happens if it takes less than 10 days -
                                   Plan     10             10                  16

                                  Actual <10 (6)           10                  16

                          Because of working to task due dates
                          the positive variation is not passed on (usually)
Copyright © 2012 by Oded Cohen              Oded Cohen – TOC For Contractors        28
CCPM – Injection 4
                 DE
            E                     Buffers are inserted in strategic points
                       N
        D

                        B
    U

                        R
                 Inj

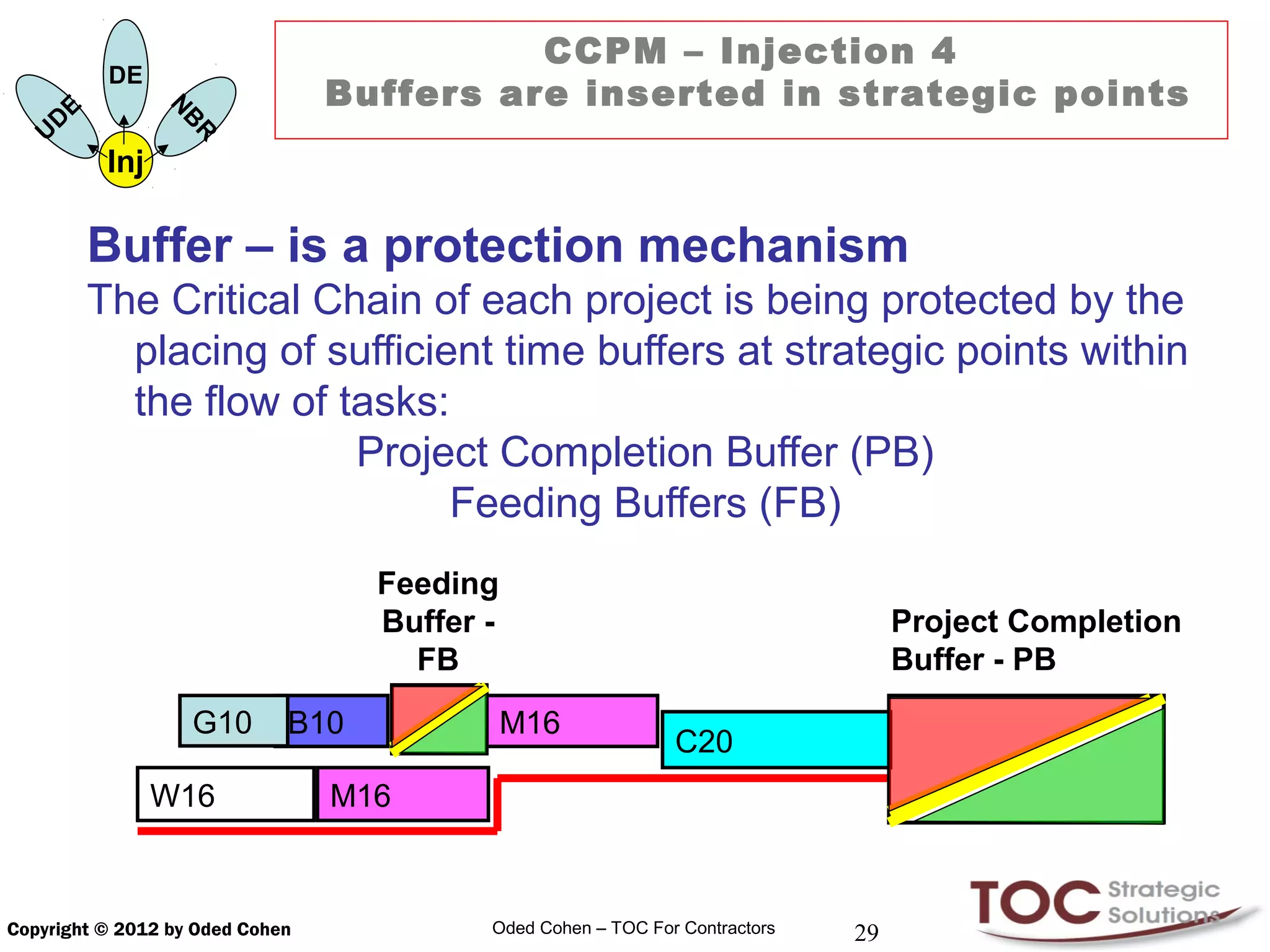

                Buffer – is a protection mechanism
                The Critical Chain of each project is being protected by the
                  placing of sufficient time buffers at strategic points within
                  the flow of tasks:
                               Project Completion Buffer (PB)
                                     Feeding Buffers (FB)
                                       Feeding
                                       Buffer -                                       Project Completion
                                         FB                                           Buffer - PB
                           G10   B10              M16
                                                                  C20
                       W16         M16

Copyright © 2012 by Oded Cohen                Oded Cohen – TOC For Contractors   29
Execution Control
                                   the TOC Way

                            CCPM - Injections 5-9

Copyright © 2012 by Oded Cohen       Oded Cohen – TOC For Contractors   30
TOC Solution for Single Project
Management
                                       Tactics:
        The Project organization implements Critical Chain project management

              Mindset:                    Planning
   Projects to Customers
                                                                             Execution Control
           are the                     Injections 2-4                          Injections 5-9
   Prime Driver – the Drum
         Injection 1

        Injection 5              Injection 6        Injection 7              Injection 8   Injection 9
         Reporting                Resource           Recovery                  POOGI         Critical
    Buffer Management
          Priority
                                 availability         Actions                              Resources

   Criteria for Good Execution Control : Priority, Recovery, POOGI
  The Reality of the Project Execution – DELAYS!

               The TOC Way means:          Manage through the Buffers!
Copyright © 2012 by Oded Cohen            Oded Cohen – TOC For Contractors     31
Introduction to Execution Control

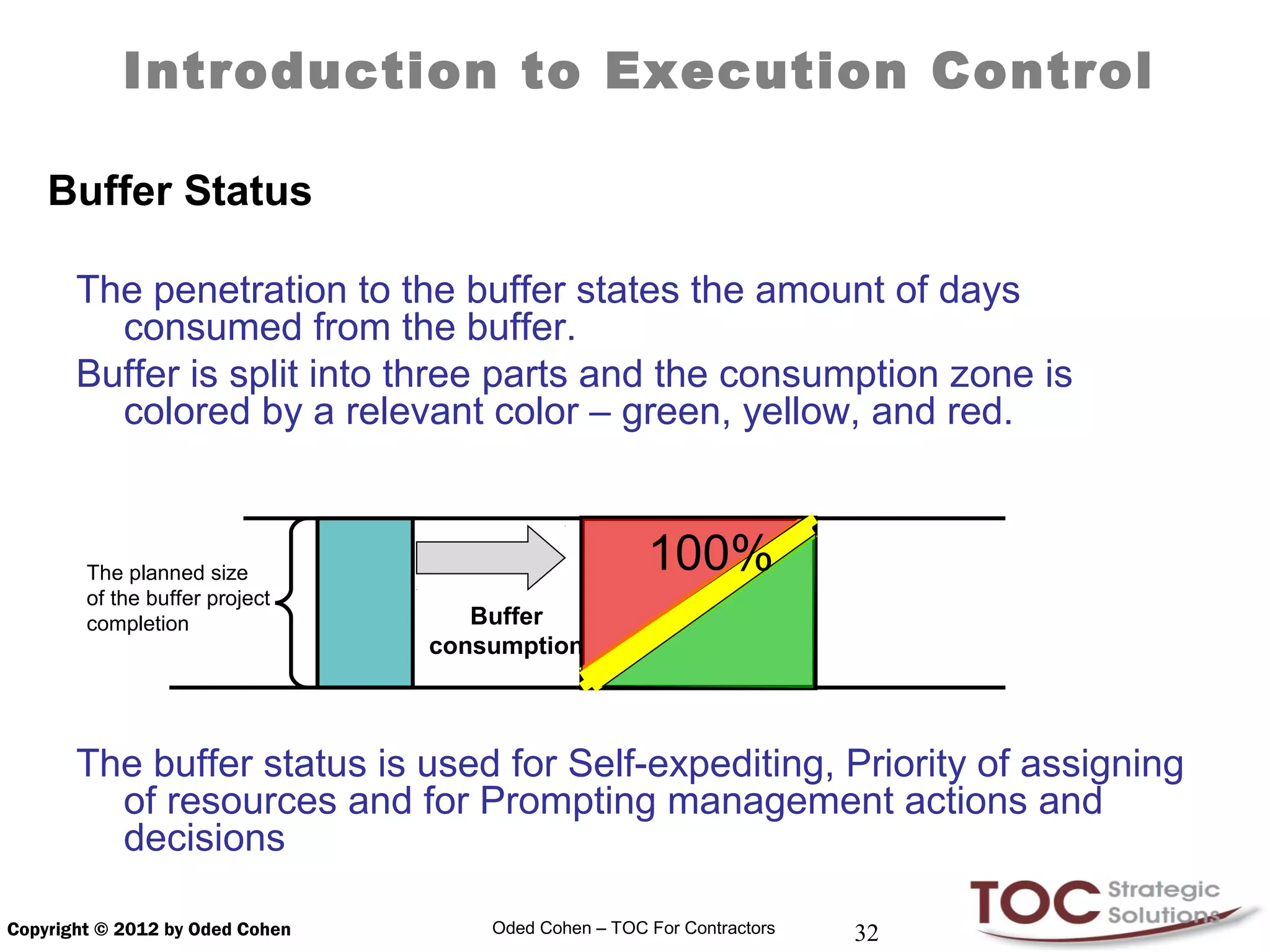

    Buffer Status

       The penetration to the buffer states the amount of days
         consumed from the buffer.
       Buffer is split into three parts and the consumption zone is
         colored by a relevant color – green, yellow, and red.

        The planned size                              100%
        of the buffer project
        completion                  Buffer
                                 consumption

       The buffer status is used for Self-expediting, Priority of assigning
         of resources and for Prompting management actions and
         decisions

Copyright © 2012 by Oded Cohen       Oded Cohen – TOC For Contractors   32
CCPM - Injection 5

         Tasks are performed according to the
          status of their corresponding buffers
           through using Buffer Management.
        Resources inform daily how much time it
          will take them to complete the task.

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   33

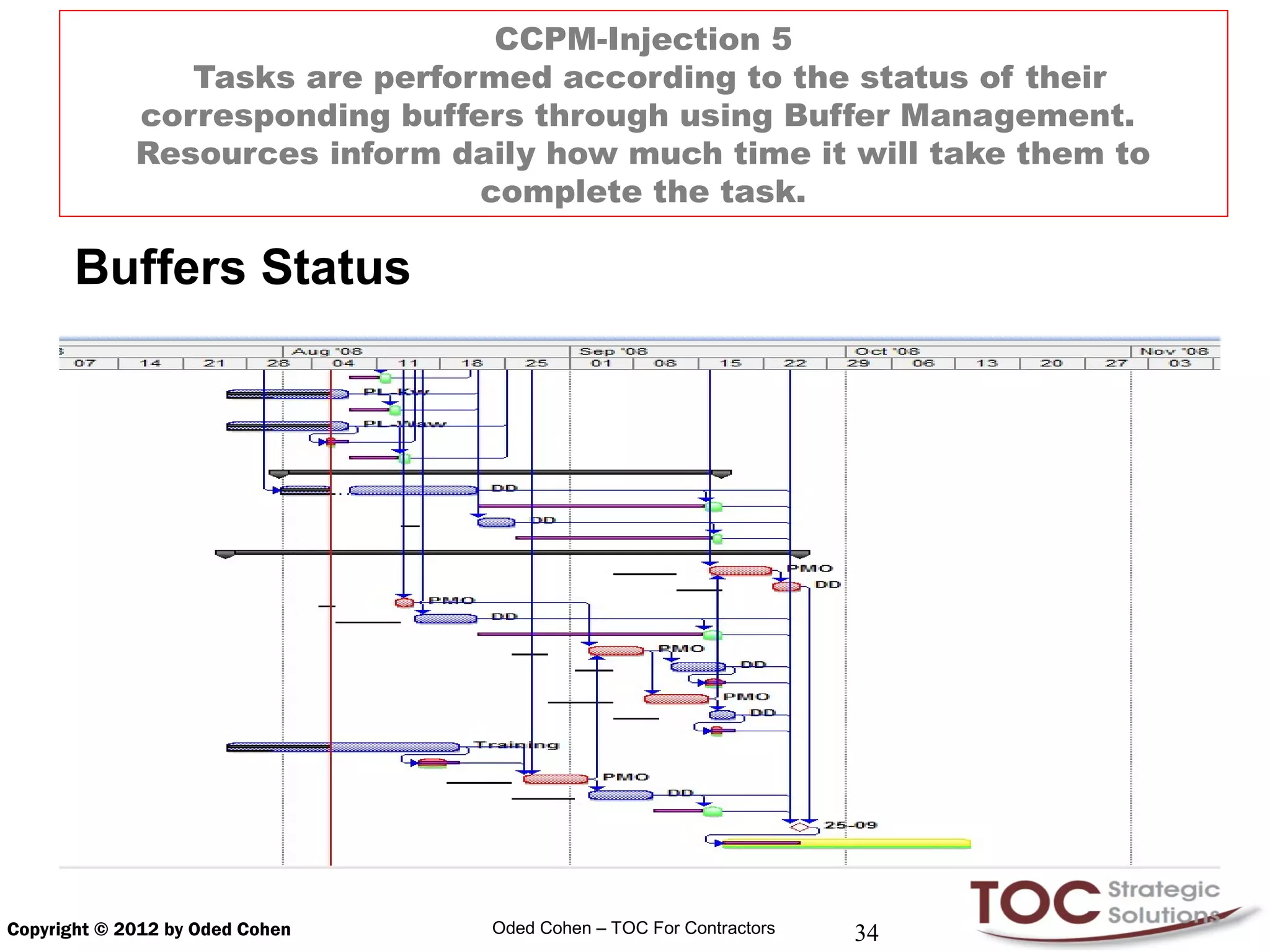

CCPM-Injection 5
                Tasks are performed according to the status of their
             corresponding buffers through using Buffer Management.
             Resources inform daily how much time it will take them to
                                complete the task.

       Buffers Status

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   34
CCPM-Injection 6
                Resource Availability is monitored in
                anticipation of a new planned task

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   35
E
              DE                           CCPM-Injection 6
                                 Resource Availability is monitored in
                    N
      D

                    B
  U

                    R
              Inj
                                  anticipation of a new planned task

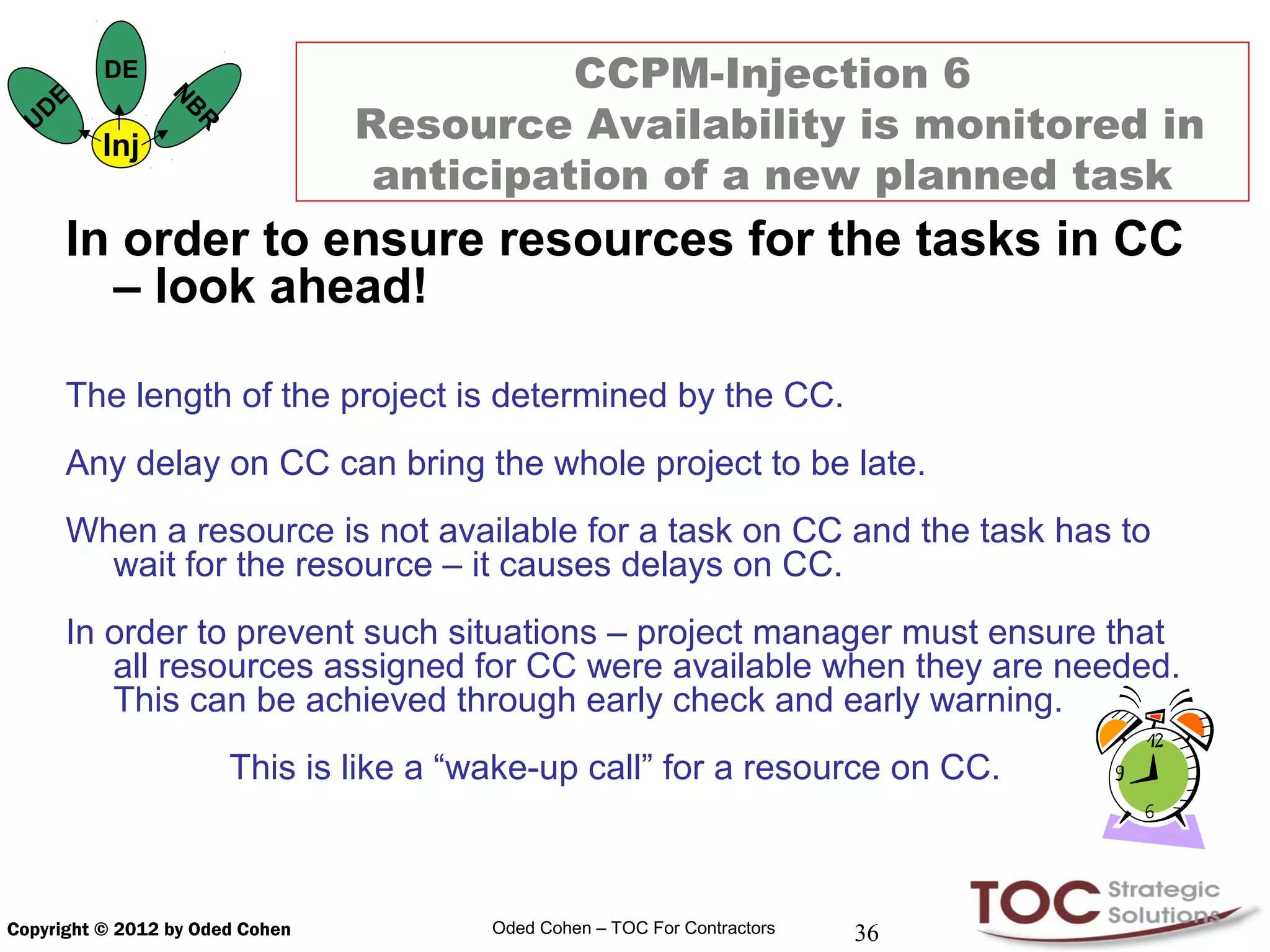

          In order to ensure resources for the tasks in CC
            – look ahead!

          The length of the project is determined by the CC.
          Any delay on CC can bring the whole project to be late.
          When a resource is not available for a task on CC and the task has to
            wait for the resource – it causes delays on CC.
          In order to prevent such situations – project manager must ensure that
             all resources assigned for CC were available when they are needed.
             This can be achieved through early check and early warning.
                        This is like a “wake-up call” for a resource on CC.

Copyright © 2012 by Oded Cohen           Oded Cohen – TOC For Contractors   36
CCPM-Injection 7
                  BM for recovery actions is in place

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   37
DE
                          CCPM-Injection 7
         E           BM for corrective actions
                   N
       D

                    B
     U

                     R

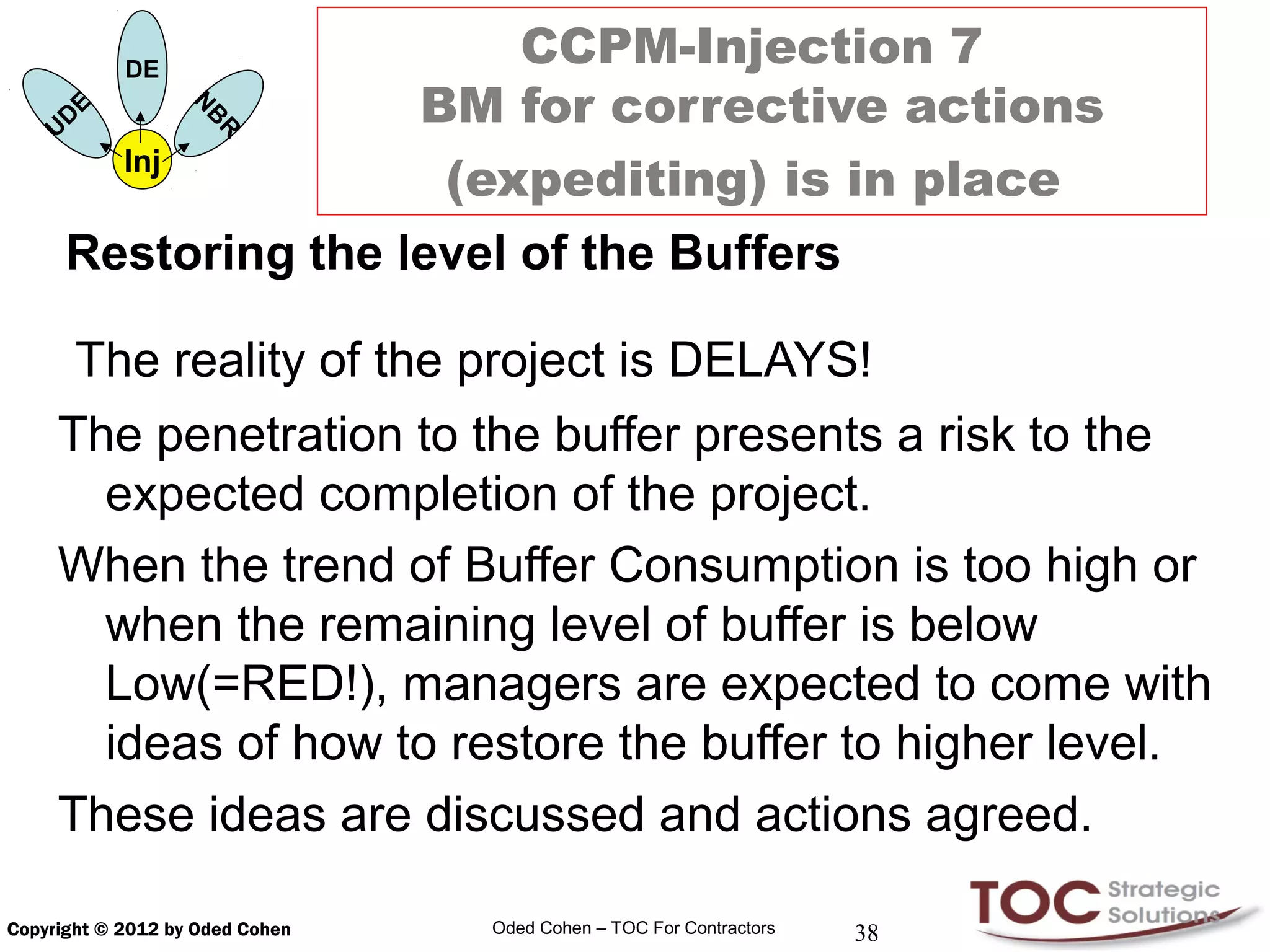

           Inj
                      (expediting) is in place
      Restoring the level of the Buffers

       The reality of the project is DELAYS!
     The penetration to the buffer presents a risk to the
       expected completion of the project.
     When the trend of Buffer Consumption is too high or
       when the remaining level of buffer is below
       Low(=RED!), managers are expected to come with
       ideas of how to restore the buffer to higher level.
     These ideas are discussed and actions agreed.

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   38

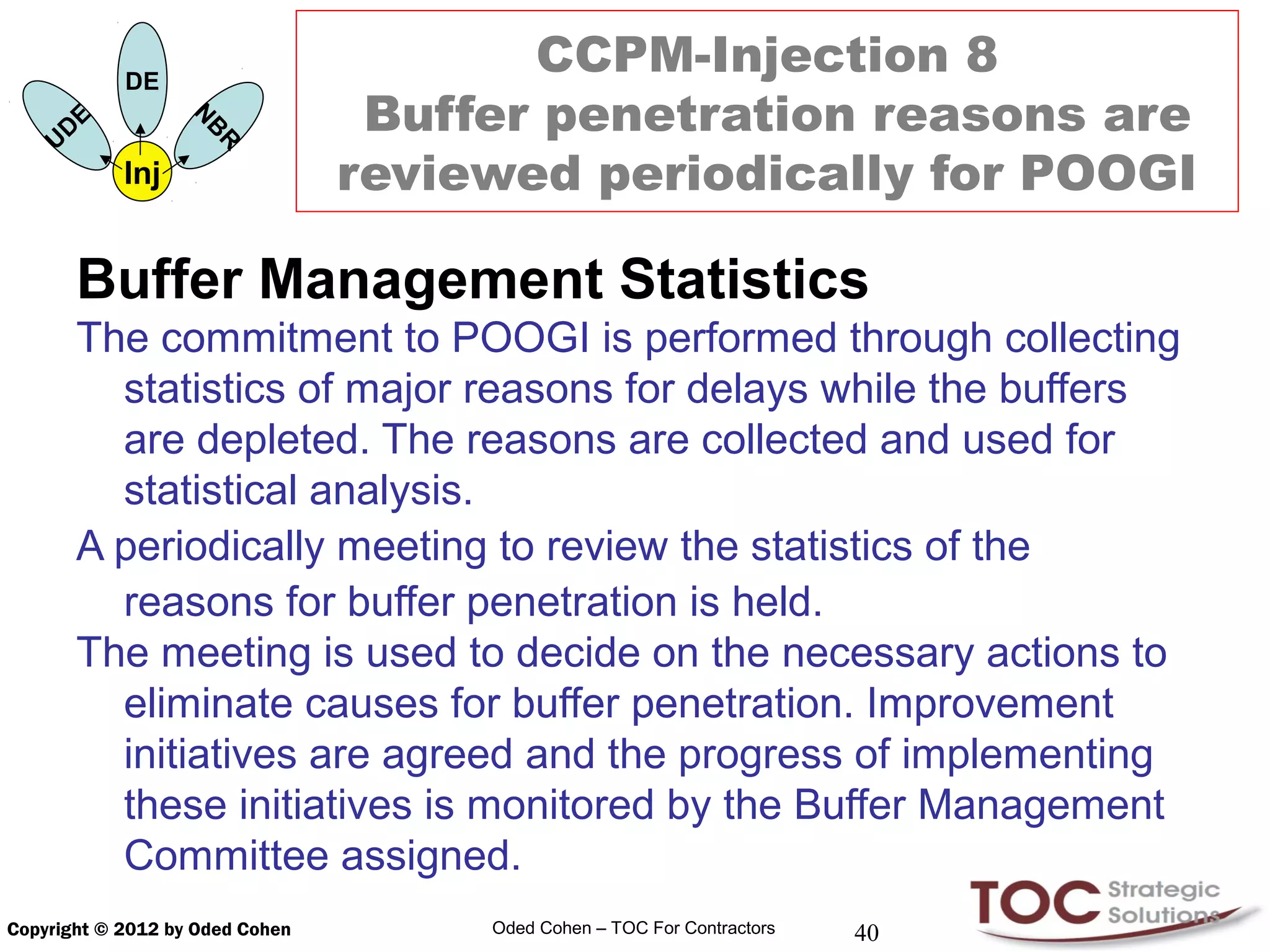

CCPM-Injection 8
                     Buffer penetration reasons are
                    reviewed periodically for POOGI

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   39
DE
                                        CCPM-Injection 8
             E                    Buffer penetration reasons are
                       N
         D

                       B
     U
                                 reviewed periodically for POOGI
                       R
                 Inj

         Buffer Management Statistics
         The commitment to POOGI is performed through collecting
           statistics of major reasons for delays while the buffers
           are depleted. The reasons are collected and used for
           statistical analysis.
         A periodically meeting to review the statistics of the
           reasons for buffer penetration is held.
         The meeting is used to decide on the necessary actions to
           eliminate causes for buffer penetration. Improvement
           initiatives are agreed and the progress of implementing
           these initiatives is monitored by the Buffer Management
           Committee assigned.
Copyright © 2012 by Oded Cohen        Oded Cohen – TOC For Contractors   40
CCPM-Injection 9

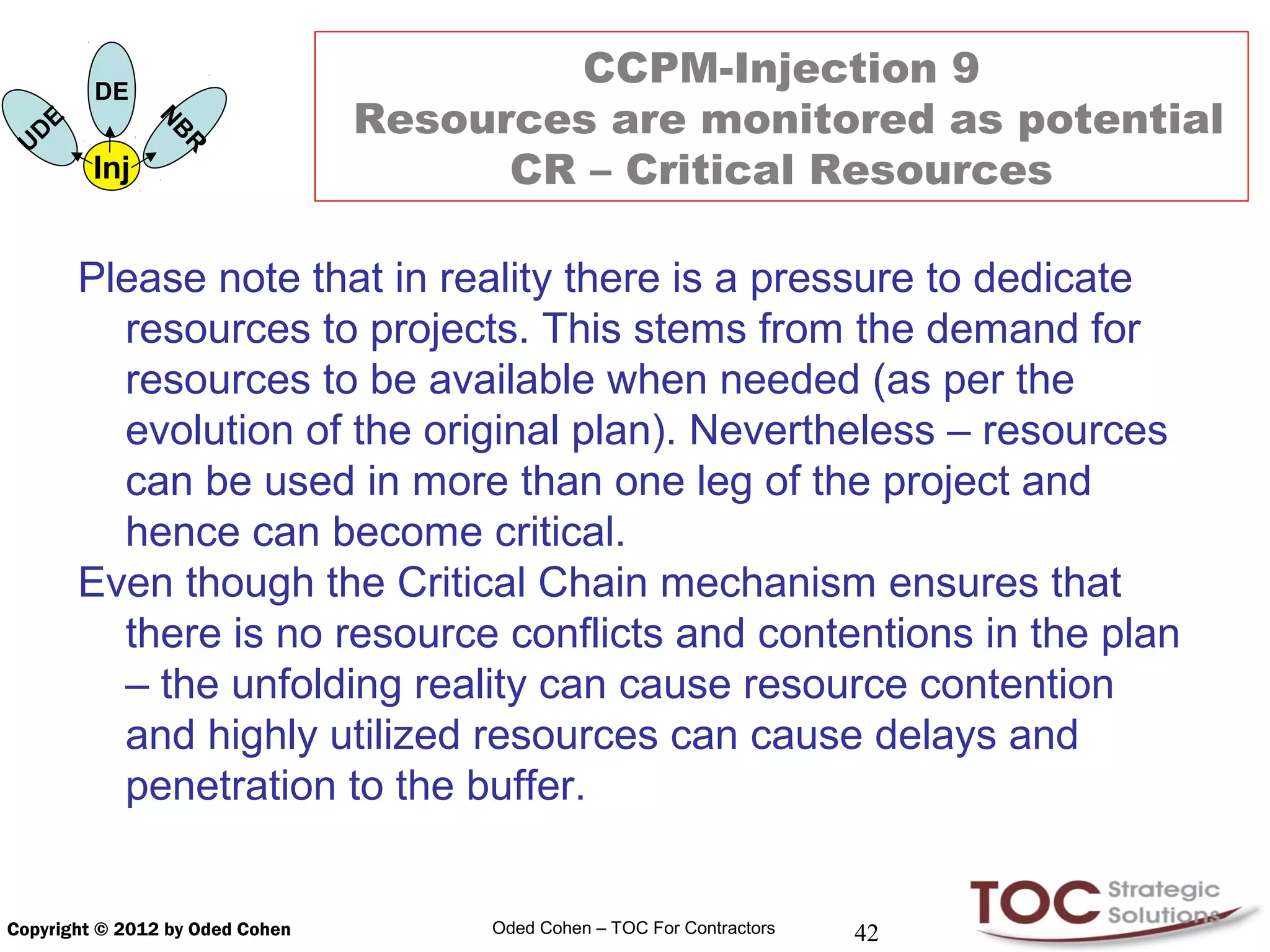

             Resources are monitored as potential
                  CR – Critical Resources

Copyright © 2012 by Oded Cohen   Oded Cohen – TOC For Contractors   41
DE
                                         CCPM-Injection 9
          E                      Resources are monitored as potential
                    N
      D
                    B
  U
              Inj   R                  CR – Critical Resources

              Please note that in reality there is a pressure to dedicate
                resources to projects. This stems from the demand for
                resources to be available when needed (as per the
                evolution of the original plan). Nevertheless – resources
                can be used in more than one leg of the project and
                hence can become critical.
              Even though the Critical Chain mechanism ensures that
                there is no resource conflicts and contentions in the plan
                – the unfolding reality can cause resource contention
                and highly utilized resources can cause delays and
                penetration to the buffer.

Copyright © 2012 by Oded Cohen        Oded Cohen – TOC For Contractors   42

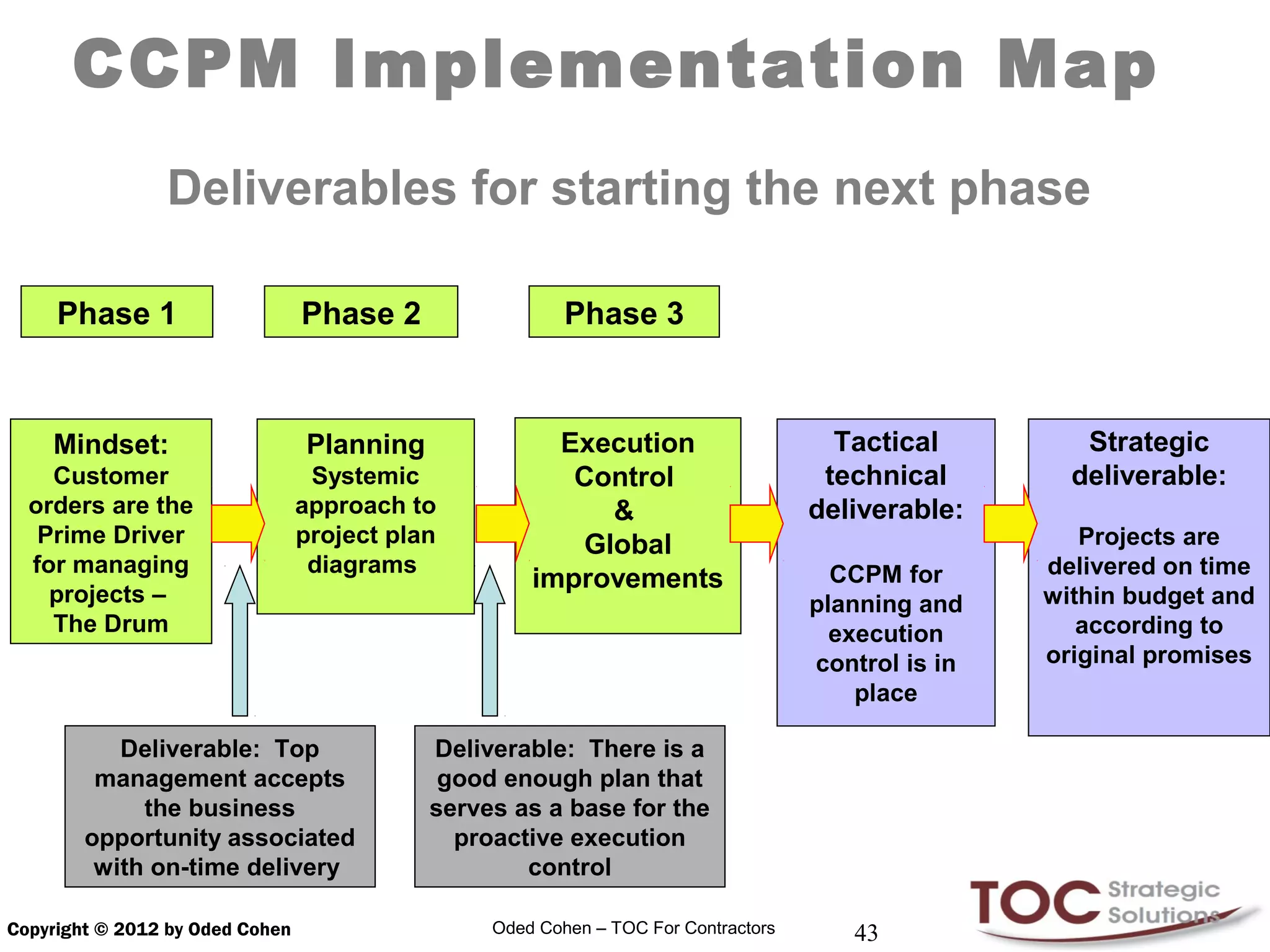

CCPM Implementation Map
                Deliverables for starting the next phase

     Phase 1                     Phase 2                 Phase 3

    Mindset:                     Planning              Execution                      Tactical         Strategic
    Customer                      Systemic              Control                      technical        deliverable:
  orders are the                 approach to              &                         deliverable:
   Prime Driver                  project plan           Global                                         Projects are
  for managing                    diagrams                                            CCPM for      delivered on time
                                                     improvements
    projects –                                                                      planning and    within budget and
    The Drum                                                                          execution        according to
                                                                                    control is in   original promises
                                                                                        place

           Deliverable: Top                 Deliverable: There is a
         management accepts                  good enough plan that
             the business                   serves as a base for the
        opportunity associated                proactive execution
         with on-time delivery                      control

Copyright © 2012 by Oded Cohen                   Oded Cohen – TOC For Contractors      43

What would you do if government suddenly became a really demanding client? Oded Cohen

  • 1.
    Public Sector Efficiency Conference Contractors parallel session: "What would you do if the government suddenly became a really demanding client?" Vilnius, September 2012 Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 1
  • 2.
    Oded Cohen Oded has nearly 35 years of experience in developing, teaching and implementing TOC methodology, solutions and implementation processes working directly with Dr. Goldratt all over the world. Among the countries to which Oded brings his expertise are the USA, Canada, Japan, India, China, the UK, Poland, Russia, Ukraine, Colombia, Chile, Peru, Turkey and many others. Oded has authored multiple TOC articles and contributed to several TOC books. Oded in the is the author of Ever Improve – A Guide to Managing Production the TOC Way, published in June 2010. Oded co-authored the book Deming & Goldratt: The Theory of Constraints and the System of Profound oded.cohen.gs@gmail.com Knowledge – The Decalogue. www.toc-strategicsolutions.com Together with Jelena Fedurko Oded has co- authored the book TOC Fundamentals, recently published in Russian. Copyright © 2012 by Oded Cohen 2
  • 3.
    Supplying to theState/Government • This session is for contractors that provide the State or the Government deliverables that have the nature of projects. • Typical projects are in construction, infrastructure, IT, new product development, etc. • As such contractors are expected to meet three conditions – the projects that they are committed to fulfill should be:  On Time  Within Budget  According to the agreed specifications (promises) • The Reality of projects is dominated by uncertainty. As such it is extremely difficult and seems unrealistic to expect to meet the three conditions of Time, Budget and Specifications. • Nevertheless, it is likely that more and more State bodies may demand from the contractors to meet these conditions. Contractors may find such situations challenging. Let’s see what TOC offers. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 3
  • 4.
    TOC Offer –CCPM Critical Chain Project Management CCPM Implementations in the Public Sector Working with Contractors • Defense -  MRO - Maintenance, Repair and Overhaul  New Product Development • Infrastructure – Roads, Bridges, Railway, Buildings • Utilities -  Air Control  Water, Electricity etc. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 4
  • 5.
    Copyright © 2012by Oded Cohen 5
  • 6.
    Results Summar yof many dif ferent project companies • Delivery Performance >95% • Lead Time reduced by 30% • Costs reduced by 15-20% • Capacity increased by 30-50% All without any significant investment – just changing the rules, policies and measures Results achieved within 6-9 months Copyright © 2012 by Oded Cohen 6
  • 7.
    What is uniqueabout CCPM – Critical Chain Project Management? TOC provides a managerial approach to better manage uncertainty that dominates projects.  TOC recognizes that key constraint of projects is the Critical Chain – the shortest chain of dependent activities while the dependency is not only logical but also through the resource availability.  Critical Chain is used for better planning and better controlling the execution of projects plans. • In Project Planning – CCPM promotes good and realistic project plans with built-in protection – Project Buffers and Feeding Buffers. • In Project Execution – CCPM promotes Buffer Management, Priority setting, Early Warning and Recovery Actions. • TOC Provides focus by setting the measurement for project management – to be a reliable provider. • Outstanding performance – reliability and competitive lead times can bring the provider more sales. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 7
  • 8.
    Why is itso difficult to deliver on time • There are too many uncertainties stemming from  the nature of the project (first time, new technology etc.),  the lack of control (customers’ instructions, bureaucracy, other contractors etc.)  and Murphy – what can go wrong – will! • Typical situations that can block the progress of State Projects:  There are too many cost overruns against budget – materials, resources etc.  Existing projects are disrupted by ‘extra work’  Many tasks (activities) take longer than planned  Progress payments are not received when expected  Revisions for late changes to scope hold us up  Too much rework  Too much overtime (especially before milestones and towards the end of the project)  Too many resources are not available when needed (they have many simultaneous tasks)  Priorities constantly shift  Top management under pressure to add more resources  Often scope or specifications are cut from a project TOC claims that a Core Problem is responsible for the existence of the majority of these problems. Any solution must address the Core Problem. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 8
  • 9.
    Understanding the Problem Current Reality B D Core Problem A A conflict diagram - Core Cloud C D’ B D Ensure the project Take is on-time corrective actions and in full that compromise (according to specs) project budget A commitments Run projects successfully D’ C Do not take corrective actions Protect budget that compromise commitments project budget commitments Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 9
  • 10.
    Analysis and solutionapplication What to change? What to change to? Low Performance High Performance Measurements Measurements Future Reality • Elements of the Current Reality GAPS solution and • Closing the Gaps Gap Analysis • Logic of the solution • Benefits Core TOC direction of solution Problem PIVOT Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 10
  • 11.
    The TOC Pivot– Managing Constraints Lift The PIVOT GAP TOC Block THE PAST TODAY THE FUTURE What is the constraint of the project management? When does the system create value for the goal of making more money? The shorter is the time to complete the project – the better! At the completion of the project – Throughput is generated and money invested is starting to be returned! Conclusion: Projects have the TIME constraint. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 11
  • 12.
    TOC Direction ofSolution CCPM – Critical Chain Project Management: The TIME constraint of the project is Future Reality presented through the Critical Chain – the longest chain of dependent activities. Managing the project through the CC is geared to finish the project in a safe and quick way. TOC direction of solution Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 12
  • 13.
    Overview of theTOC Solution for Project Management CCPM Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 13
  • 14.
    TOC Solution forSingle Project Management Strategy: The Project is On Time, In Full & Within Budget Tactics: The Project organization implements Critical Chain project management Mindset: Projects to Customers Planning Execution Control are the Injections 2-4 Injections 5-9 Prime Driver – the Drum Injection 1 The Prime Measurement Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 14
  • 15.
    CCPM – Injection1 Achievement of the delivery commitments is established as a Prime Measurement for managing project environment Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 15
  • 16.
    CCPM – Injection1 DE Achievement of the delivery commitments is E established as a Prime Measurement for N D B U R managing project environment Inj Measuring On Time Delivery 1. Reliability - The number of projects that were delivered on-time (or early) versus the total number of projects within time “buckets” (e.g. month, quarter, year). [Percentage] 2. For internal use: The amount of money that has been delivered on time or early versus the total value of the projects within time buckets [Percentage]. 3. Also for internal use : The financial impact of the late delivery – T$D – Throughput Dollar Days. [the amount of money delayed multiplied by the number of days late] Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 16
  • 17.
    Project Planning theTOC Way CCPM - Injections 2-4 Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 17
  • 18.
    TOC Solution forSingle Project Management Tactics: The Project organization implements Critical Chain project management Mindset: Projects to Customers Planning Execution are the Injections 2-4 Control Prime Driver – the Drum Injections 5-9 Injection 1 Injection 2 Injection 3 Injection 4 Project Planning Critical Chain Diagrams Plan Buffers Criteria for a Good Project Plan: • Provide Financial Benefits • Realistic • Immunized against Disruptions Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 18
  • 19.
    CCPM – Injection2 Project Planning Diagrams are in place with tasks resourced and estimated for duration – while estimates of durations are challenging but achievable Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 19
  • 20.
    CCPM – Injection2 DE E Project Planning Diagrams are in place N D with tasks resourced and estimated for duration – while B U Inj R estimates of durations are challenging but achievable Project Planning Diagram Build a diagram of task dependencies and check its quality in accordance with the following criteria:  Completeness – No more than 400 tasks  All dependencies are identified  The deliverables ("output") of each task clearly known  All tasks are connected "Finish-Start”  Feasibility  Required resource(s) – main resources, no fractional and no specific names  Duration of tasks – no forced dates CCPM-Injection 2 establishes a mechanism and procedures to develop a quality diagram of the project plan, with duration of the tasks to be set “Challenging, but achievable“. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 20
  • 21.
    CCPM – Injection2 DE Project Planning Diagrams are in place E with tasks resourced and estimated for duration – while N D B U R Inj estimates of durations are challenging but achievable Estimation times – Current reality in projects Why? Because of Task duration - Behavioral reasons the behaviour of for 80% probability distribution managers – in planning phase managers ask for •Students syndrome estimations in execution – • Parkinson’s Law they treat Probability of • Bad multitasking estimations as completion justified commitments Tasks contain a lot of safety! 50% 80% Time Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 21
  • 22.
    CCPM – Injection2 DE Project Planning Diagrams are in place E with tasks resourced and estimated for duration – while N D B U R Inj estimates of durations are challenging but achievable Task duration – Behavior Estimation times – must go through a challenging process Probability of Probability of completion 50%80% Time completion 50% 80% Time TOC approach – estimates of duration should be challenging but achievable! In majority of the cases the duration with 50% probability equals HALF the duration with 80% probability. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 22
  • 23.
    CCPM – Injection3 Critical Chain determined through resolving resource contention Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 23
  • 24.
    DE CCPM – Injection 3 E Critical Chain determined through resolving N D B U resource contention R Inj Making the project plan realistic means that we identify and address resource contention situation. This is happening when the plan calls for the same resource to perform more than one task at the same time. Two mechanisms are used to handle the situations: 1. By re-assigning resources that are likely to be available when needed by the plan 2. By sequencing the tasks by creating dependence between tasks due to availability of resources – this is the Critical Chain Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 24
  • 25.
    DE CCPM – Injection 3 E Critical Chain determined through resolving N D B U resource contention R Inj Sorting out Resource Contention: The Critical Chain is the chain of dependent events - one that takes into consideration all dependencies (including resource dependency). Critical Path Promise = 56 days G10 B10 M16 Letter and M16 - Resource contention! C20 Finish Colour = Resource W16 M16 Critical Chain G10 B10 M16 C20 Finish W16 M16 68 days Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 25
  • 26.
    DE CCPM – Injection 3 E Critical Chain determined through resolving N D B U resource contention R Inj The role of Critical Chain in managing projects The Critical Chain is the chain of task and resource dependencies that prevents the project from being planned in a shorter interval, given finite resources. The Critical Chain provides the major focus and back bone for the planning. It plays even more important role in controlling the execution of the plan. Hence – the name of the solution - CCPM Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 26
  • 27.
    CCPM – Injection4 Buffers are inserted in strategic points Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 27
  • 28.
    E DE CCPM – Injection 4 N D Buffers are inserted in strategic points B U R Inj Reality in projects – Working to task due dates What happens if it takes more than 10 days - Plan 10 10 16 Actual > 10 (15) 10 16 RESULT - The delay of 5 days is passed on - the project is ”said to have “moved to the right What happens if it takes less than 10 days - Plan 10 10 16 Actual <10 (6) 10 16 Because of working to task due dates the positive variation is not passed on (usually) Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 28
  • 29.
    CCPM – Injection4 DE E Buffers are inserted in strategic points N D B U R Inj Buffer – is a protection mechanism The Critical Chain of each project is being protected by the placing of sufficient time buffers at strategic points within the flow of tasks: Project Completion Buffer (PB) Feeding Buffers (FB) Feeding Buffer - Project Completion FB Buffer - PB G10 B10 M16 C20 W16 M16 Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 29
  • 30.
    Execution Control the TOC Way CCPM - Injections 5-9 Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 30
  • 31.
    TOC Solution forSingle Project Management Tactics: The Project organization implements Critical Chain project management Mindset: Planning Projects to Customers Execution Control are the Injections 2-4 Injections 5-9 Prime Driver – the Drum Injection 1 Injection 5 Injection 6 Injection 7 Injection 8 Injection 9 Reporting Resource Recovery POOGI Critical Buffer Management Priority availability Actions Resources Criteria for Good Execution Control : Priority, Recovery, POOGI The Reality of the Project Execution – DELAYS! The TOC Way means: Manage through the Buffers! Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 31
  • 32.
    Introduction to ExecutionControl Buffer Status The penetration to the buffer states the amount of days consumed from the buffer. Buffer is split into three parts and the consumption zone is colored by a relevant color – green, yellow, and red. The planned size 100% of the buffer project completion Buffer consumption The buffer status is used for Self-expediting, Priority of assigning of resources and for Prompting management actions and decisions Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 32
  • 33.
    CCPM - Injection5 Tasks are performed according to the status of their corresponding buffers through using Buffer Management. Resources inform daily how much time it will take them to complete the task. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 33
  • 34.
    CCPM-Injection 5 Tasks are performed according to the status of their corresponding buffers through using Buffer Management. Resources inform daily how much time it will take them to complete the task. Buffers Status Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 34
  • 35.
    CCPM-Injection 6 Resource Availability is monitored in anticipation of a new planned task Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 35
  • 36.
    E DE CCPM-Injection 6 Resource Availability is monitored in N D B U R Inj anticipation of a new planned task In order to ensure resources for the tasks in CC – look ahead! The length of the project is determined by the CC. Any delay on CC can bring the whole project to be late. When a resource is not available for a task on CC and the task has to wait for the resource – it causes delays on CC. In order to prevent such situations – project manager must ensure that all resources assigned for CC were available when they are needed. This can be achieved through early check and early warning. This is like a “wake-up call” for a resource on CC. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 36
  • 37.
    CCPM-Injection 7 BM for recovery actions is in place Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 37
  • 38.
    DE CCPM-Injection 7 E BM for corrective actions N D B U R Inj (expediting) is in place Restoring the level of the Buffers The reality of the project is DELAYS! The penetration to the buffer presents a risk to the expected completion of the project. When the trend of Buffer Consumption is too high or when the remaining level of buffer is below Low(=RED!), managers are expected to come with ideas of how to restore the buffer to higher level. These ideas are discussed and actions agreed. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 38
  • 39.
    CCPM-Injection 8 Buffer penetration reasons are reviewed periodically for POOGI Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 39
  • 40.
    DE CCPM-Injection 8 E Buffer penetration reasons are N D B U reviewed periodically for POOGI R Inj Buffer Management Statistics The commitment to POOGI is performed through collecting statistics of major reasons for delays while the buffers are depleted. The reasons are collected and used for statistical analysis. A periodically meeting to review the statistics of the reasons for buffer penetration is held. The meeting is used to decide on the necessary actions to eliminate causes for buffer penetration. Improvement initiatives are agreed and the progress of implementing these initiatives is monitored by the Buffer Management Committee assigned. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 40
  • 41.
    CCPM-Injection 9 Resources are monitored as potential CR – Critical Resources Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 41
  • 42.
    DE CCPM-Injection 9 E Resources are monitored as potential N D B U Inj R CR – Critical Resources Please note that in reality there is a pressure to dedicate resources to projects. This stems from the demand for resources to be available when needed (as per the evolution of the original plan). Nevertheless – resources can be used in more than one leg of the project and hence can become critical. Even though the Critical Chain mechanism ensures that there is no resource conflicts and contentions in the plan – the unfolding reality can cause resource contention and highly utilized resources can cause delays and penetration to the buffer. Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 42
  • 43.
    CCPM Implementation Map Deliverables for starting the next phase Phase 1 Phase 2 Phase 3 Mindset: Planning Execution Tactical Strategic Customer Systemic Control technical deliverable: orders are the approach to & deliverable: Prime Driver project plan Global Projects are for managing diagrams CCPM for delivered on time improvements projects – planning and within budget and The Drum execution according to control is in original promises place Deliverable: Top Deliverable: There is a management accepts good enough plan that the business serves as a base for the opportunity associated proactive execution with on-time delivery control Copyright © 2012 by Oded Cohen Oded Cohen – TOC For Contractors 43

Editor's Notes

  • #2 Программа Стратегиские Решения - Модуль 1 Управление производством по ТОС 23-26 ноября 2009 Москва
  • #4 Программа Стратегиские Решения - Модуль 1 Управление производством по ТОС 23-26 ноября 2009 Москва
  • #5 Программа Стратегиские Решения - Модуль 1 Управление производством по ТОС 23-26 ноября 2009 Москва
  • #8 Программа Стратегиские Решения - Модуль 1 Управление производством по ТОС 23-26 ноября 2009 Москва
  • #9 Программа Стратегиские Решения - Модуль 1 Управление производством по ТОС 23-26 ноября 2009 Москва
  • #17 Even though the term Throughput is used – we actually refer to the cash payment associated with the order.
  • #32 Wording of injections 5 and 7: To avoid confusion we have to establish a clear cut between the two injections. Injection 5 for resource allocation only . This is done through the use of BM for assigning priorities to tasks. This is nearly automatic procedure – task are given priorities according to the buffer penetration levels. The procedure for resource allocation follows from the priority assigned to the task. Injection 7 is activated when the resource allocation is not enough in order to guarantee the on time completion of the project. Usually, we should be concerned when the project completion buffer is in the red. Therefore, it is expected that project management will consider, suggest and take some drastic actions that will lead to recovery of the buffer. Recovery means that the buffer is not depleted to the extent that the on time delivery is at significant risk. In injection 7 we are looking for actions that beyond just assigning resources. Many times we look for taking actions on tasks of the critical chain that will end up by reducing the duration of a task or several tasks on the critical chain. Not always such actions are within the authority of the project manager or any of the resource managers – and a part of the process includes the thinking, suggestion and obtaining permission and funds for the recovery actions.
  • #44 Figure 12
